Benchmarking Software Estimation
Methods
Adam Boyd, Sameer Huque, Kristine Pachuta, Travis Pincoski, John Trumble
July 11, 2013

1
• Product Director at
Bloomberg LP
• Former IT Sourcing
Director at Bloomberg
and Pricing Analyst at
General Dynamics

OUR TEAM
• Sr. Education
Associate at
the American
Chemical
Society

Kristine

Adam

• Mechanical Engineer at
US Bureau of Engraving
& Printing
• Sr. Consultant at
Deloitte
Consulting LLP

Travis
• Senior Financial
Planning Analyst at BAE
Systems

Sameer
John

2
AGENDA
1 Review of Project Scope
2 Best Practices Research
3 Interview Results
4 Data Analysis and Benchmarking
5 Data Recommendations
6 Go-Forward Plan

3

OUR PROJECT SCOPE COVERED BEST PRACTICE
RESEARCH AND DATA BENCHMARKING
PROJECT SCOPE
• Compile a list of software estimation methods, best practices
and benchmarks used at competing firms in US
• Analyze GMD data and summarize findings
• Analyze third party data
• Present data and suggestions to GMD project sponsors

4
OUR RECOMMENDATIONS ARE BASED ON THE RESULTS
OF OUR RESEARCH AND ANALYSIS
1
Researched Industry
Best Practices
2

• Searched Industry Journals
• Comprehensive News Searches
• Established Summaries

Interviewed Subject
Matter Experts

• Interviewed experts across the industry
• Used standardized questions
• Established Summaries

Analyzed Available
Data

• Analyzed GMD provided data
• Analyzed third party data
• Established Equation and Recommendations

Formulated
Recommendations

• Compiled themes across all research areas
• Formulated the data model
• Delivered multiple options for recommendations

3

4

5

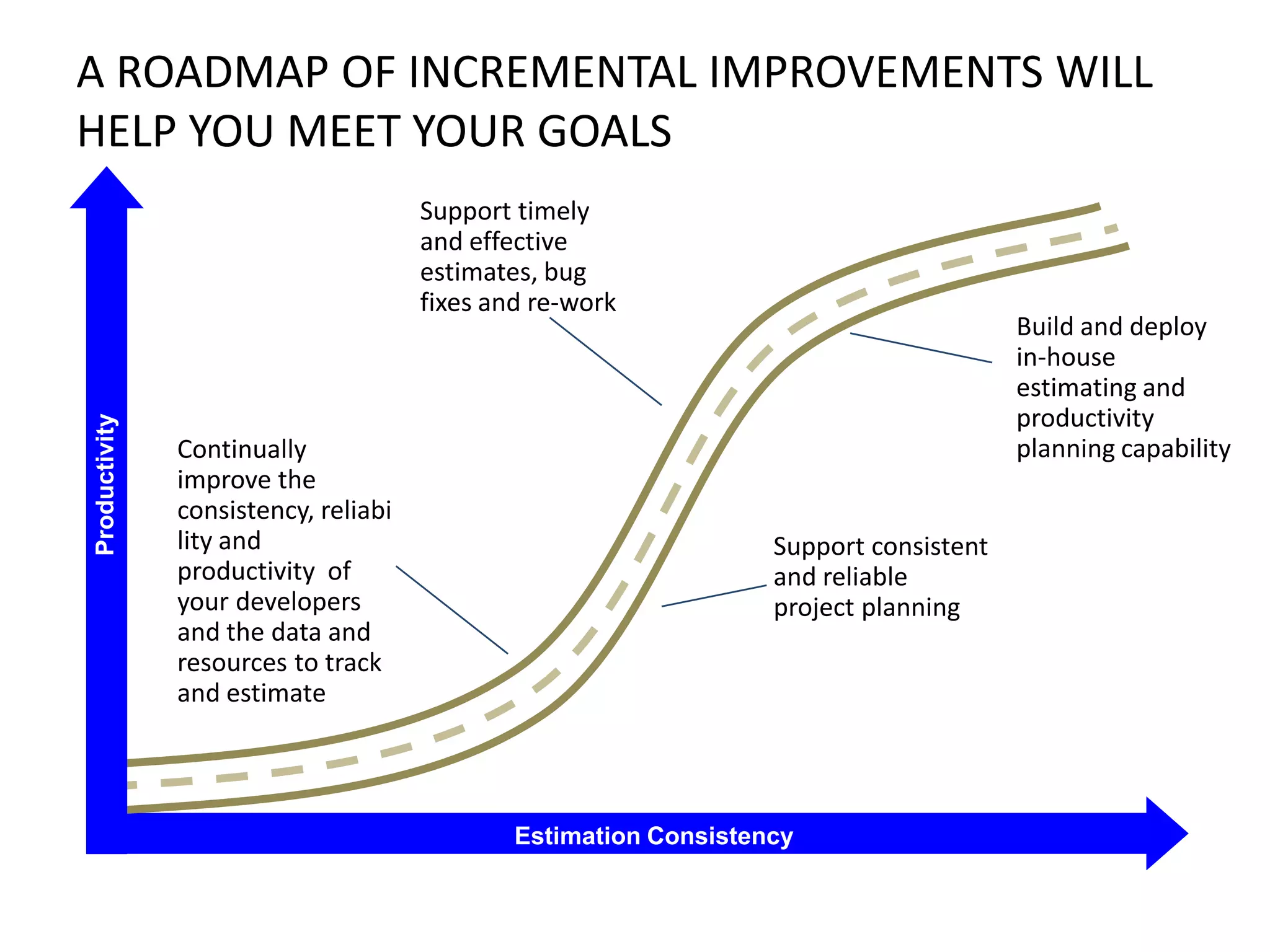

A ROADMAP OF INCREMENTAL IMPROVEMENTS WILL
HELP YOU MEET YOUR GOALS

Productivity

Support timely
and effective
estimates, bug
fixes and re-work

Continually
improve the
consistency, reliabi
lity and
productivity of
your developers
and the data and
resources to track
and estimate

Build and deploy
in-house
estimating and
productivity
planning capability
Support consistent
and reliable
project planning

Estimation Consistency
AGENDA
1 Review of Project Scope
2 Best Practices Research
3 Interview Results
4 Data Analysis and Benchmarking
5 Data Recommendations
6 Go-Forward Plan

7
SEVERAL THEMES EMERGED IN OUR RESEARCH OF
BEST PRACTICES
Theme

Research

The best
measurements
are quantitative
and qualitative

• Data should be refined and measured
• Data analysis should be coupled with soft skills analysis
• The best developers may not make the best leaders
• Measures are best used in large distributed projects

---------------------------------------------------------------------------------------------------------------Some data is
easy to game

• Metrics like lines of code are easy to trick
• Mentoring or leading projects may result in low metrics
• Refactoring or documenting are often not accounted

---------------------------------------------------------------------------------------------------------------• Metrics should not be used punitively
Metrics can be
• Comparing across projects is difficult and possibly inaccurate
de-motivating
• Project managers, not management should control
DATA MODELS SHOULD HAVE FIVE KEY
CHARACTERISTICS
Breadth

Depth

Explicit

Actionable

Automated

To handle multiple technologies
To looks at all levels of the application
Enough to test against industry standards
To show where improvements can be made
To not detract from the workload
TECHNICAL GOALS SHOULD ALIGN WITH YOUR
CORPORATE AND STRATEGIC GOALS
Technical
Goals

Software
Quality

Developer
Efficiency

Customer Satisfaction

Strategic
Goals

Product
Quality

On Time
Delivery

Customer Satisfaction

Corporate
Goals

Quality

Efficiency

Customer Satisfaction
10
AGENDA
1 Review of Project Scope
2 Best Practices Research
3 Interview Results
4 Data Analysis and Benchmarking
5 Data Recommendations
6 Go-Forward Plan

11

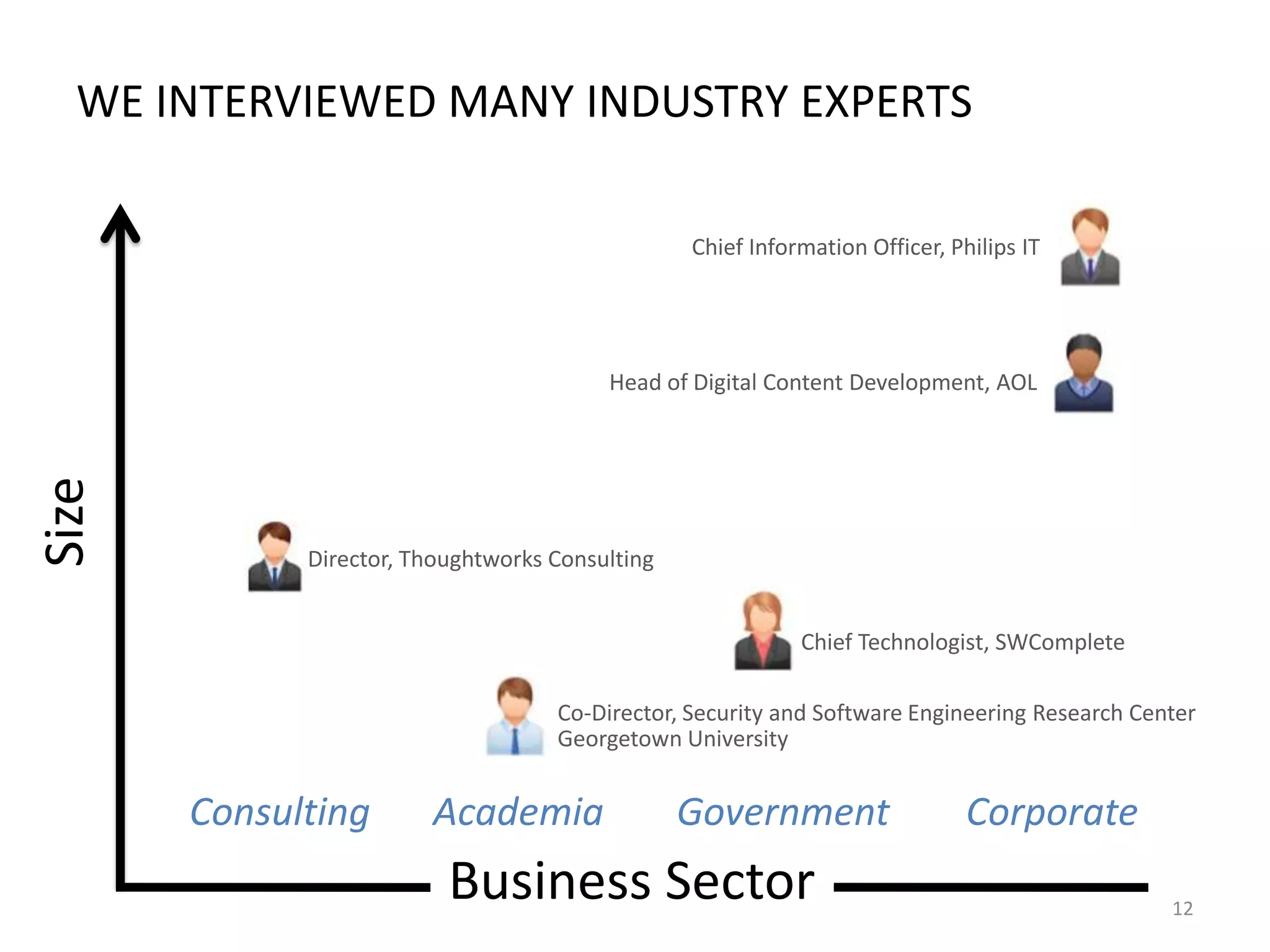

WE INTERVIEWED MANY INDUSTRY EXPERTS
Chief Information Officer, Philips IT

Size

Head of Digital Content Development, AOL

Director, Thoughtworks Consulting
Chief Technologist, SWComplete
Co-Director, Security and Software Engineering Research Center
Georgetown University

Consulting

Academia

Government

Business Sector

Corporate
12
THE EXPERTS HAVE STRONG OPINIONS ABOUT THE
NECESSITY OF MEASURING DEVELOPER OUTPUT

most formal measurement
systems may de-motivate
developers

identify the developer
that other developers
go to for advice

we don't base pay or
increase on development
metrics at all
a great developer will
have vocal ideas about
changing things AND
make it happen

peer code review is key

13

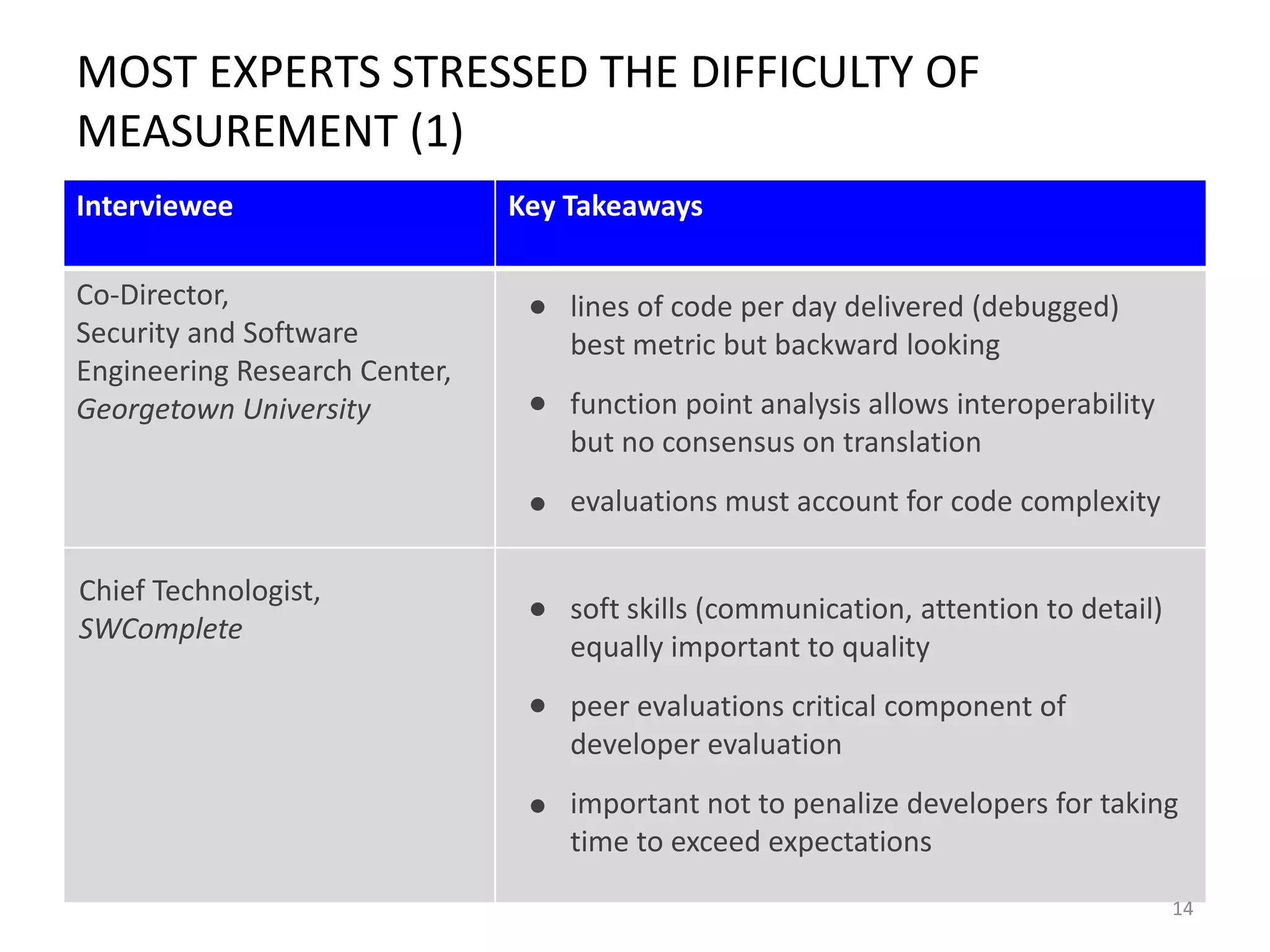

MOST EXPERTS STRESSED THE DIFFICULTY OF
MEASUREMENT (1)
Interviewee
Co-Director,
Security and Software
Engineering Research Center,
Georgetown University

Key Takeaways
lines of code per day delivered (debugged)
best metric but backward looking
function point analysis allows interoperability
but no consensus on translation
evaluations must account for code complexity

Chief Technologist,
SWComplete

soft skills (communication, attention to detail)
equally important to quality
peer evaluations critical component of
developer evaluation
important not to penalize developers for taking
time to exceed expectations
14

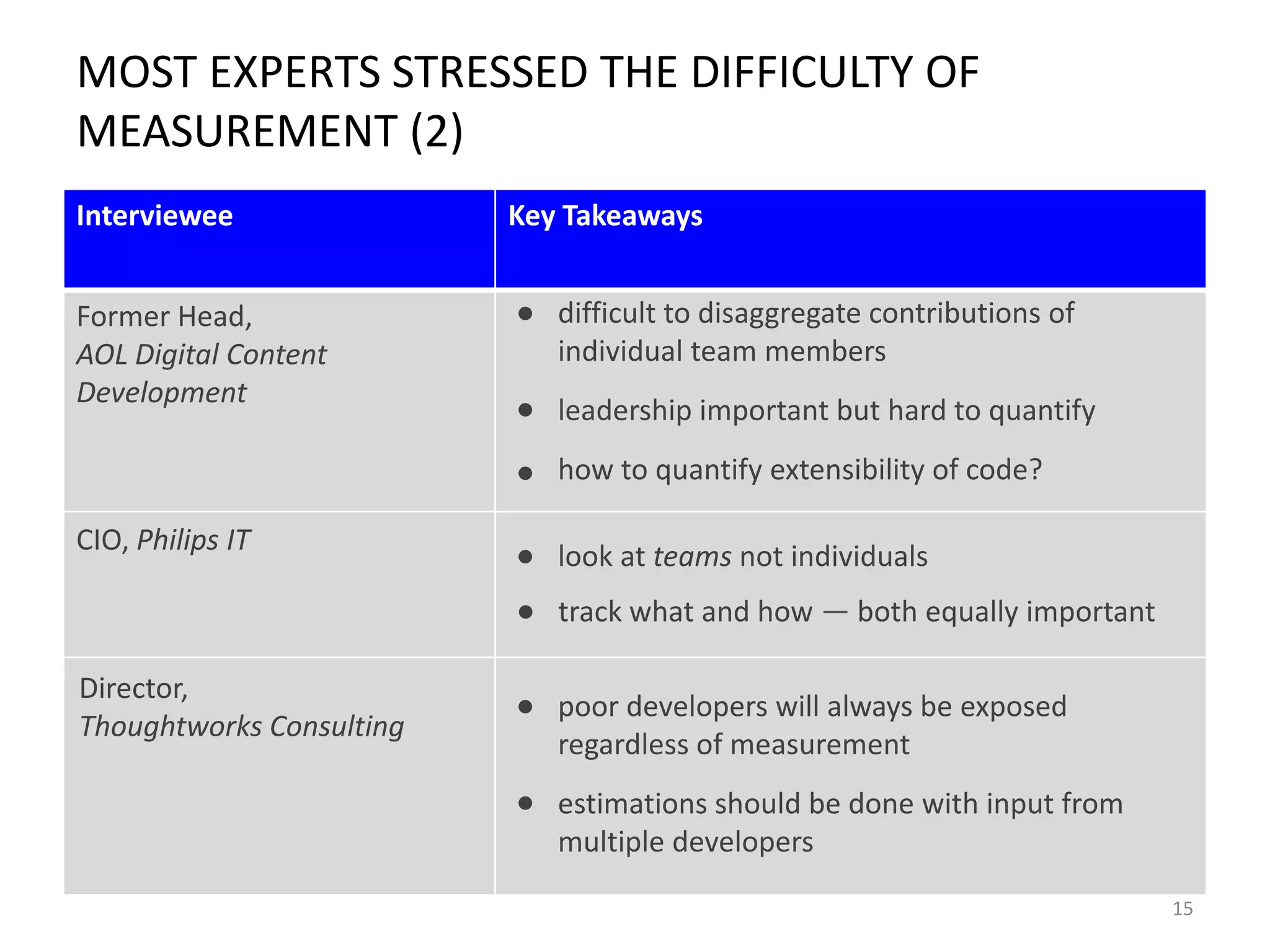

MOST EXPERTS STRESSED THE DIFFICULTY OF
MEASUREMENT (2)
Interviewee

Former Head,
AOL Digital Content
Development

Key Takeaways

difficult to disaggregate contributions of
individual team members
leadership important but hard to quantify
how to quantify extensibility of code?

CIO, Philips IT

look at teams not individuals
track what and how — both equally important

Director,
Thoughtworks Consulting

poor developers will always be exposed
regardless of measurement
estimations should be done with input from
multiple developers
15
ONLY ONE OF THE COMPANIES WE INTERVIEWED
MEASURES INDIVIDUAL DEVELOPER PRODUCTIVITY
Measures Productivity

Do Not Measure Productivity

16
AGENDA
1 Review of Project Scope
2 Best Practices Research
3 Interview Results
4 Data Analysis and Benchmarking
5 Data Recommendations
6 Go-Forward Plan

17

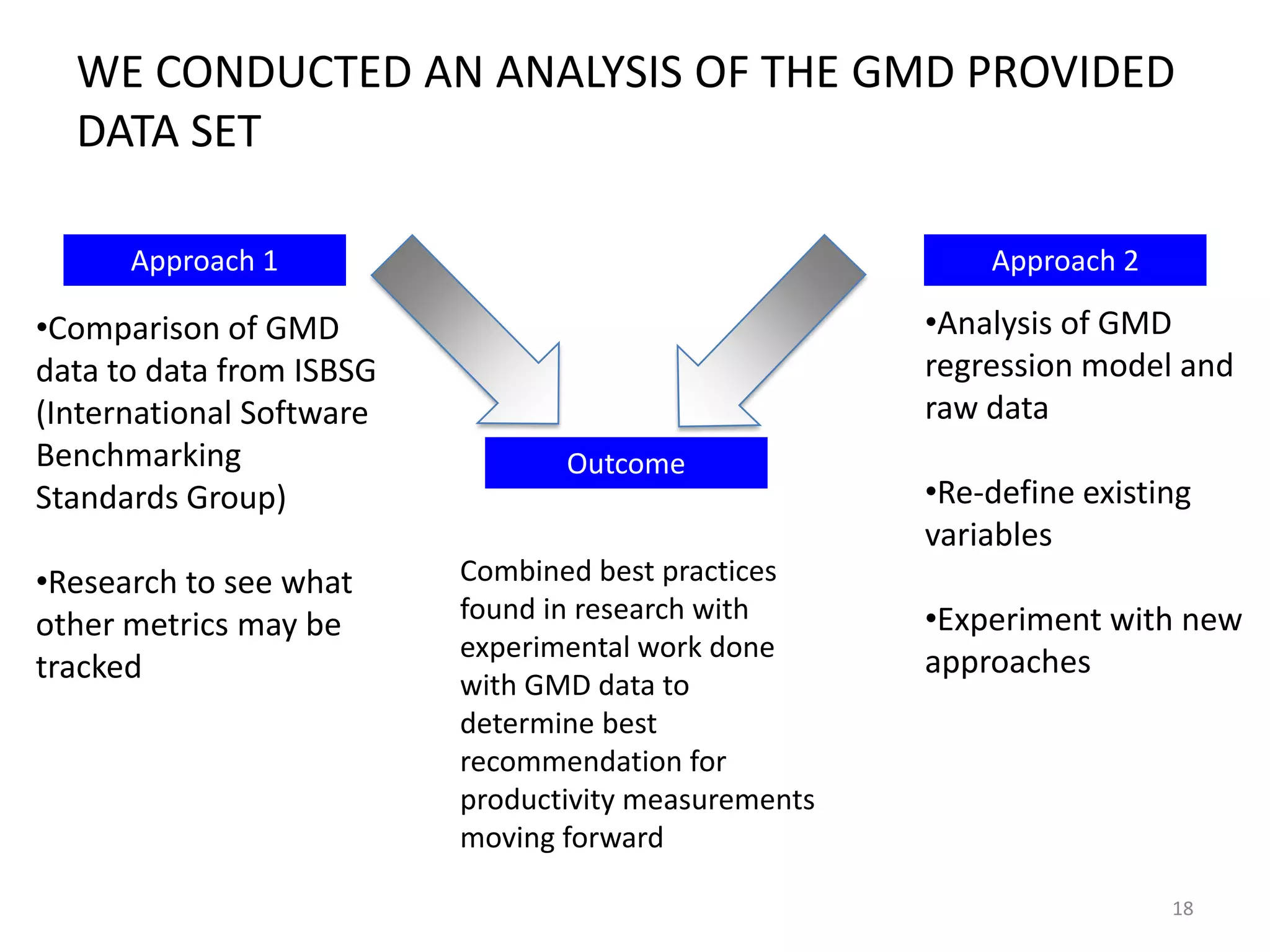

WE CONDUCTED AN ANALYSIS OF THE GMD PROVIDED
DATA SET
Approach 1

•Comparison of GMD
data to data from ISBSG
(International Software
Benchmarking
Standards Group)
•Research to see what
other metrics may be
tracked

Approach 2

•Analysis of GMD
regression model and
raw data
Outcome
Combined best practices
found in research with
experimental work done
with GMD data to
determine best
recommendation for
productivity measurements
moving forward

•Re-define existing
variables
•Experiment with new
approaches

18

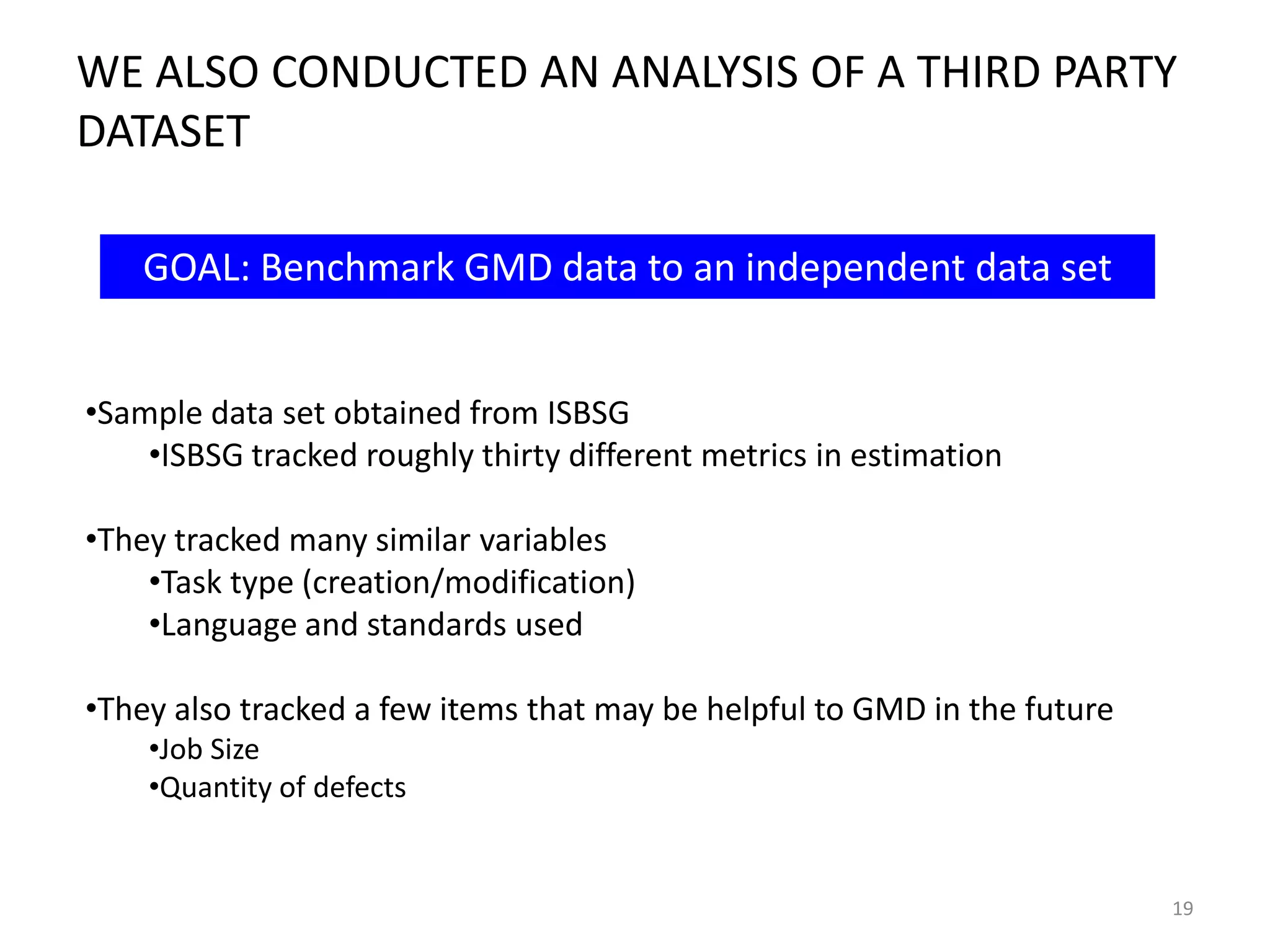

WE ALSO CONDUCTED AN ANALYSIS OF A THIRD PARTY
DATASET
GOAL: Benchmark GMD data to an independent data set
•Sample data set obtained from ISBSG
•ISBSG tracked roughly thirty different metrics in estimation
•They tracked many similar variables
•Task type (creation/modification)
•Language and standards used
•They also tracked a few items that may be helpful to GMD in the future
•Job Size
•Quantity of defects

19

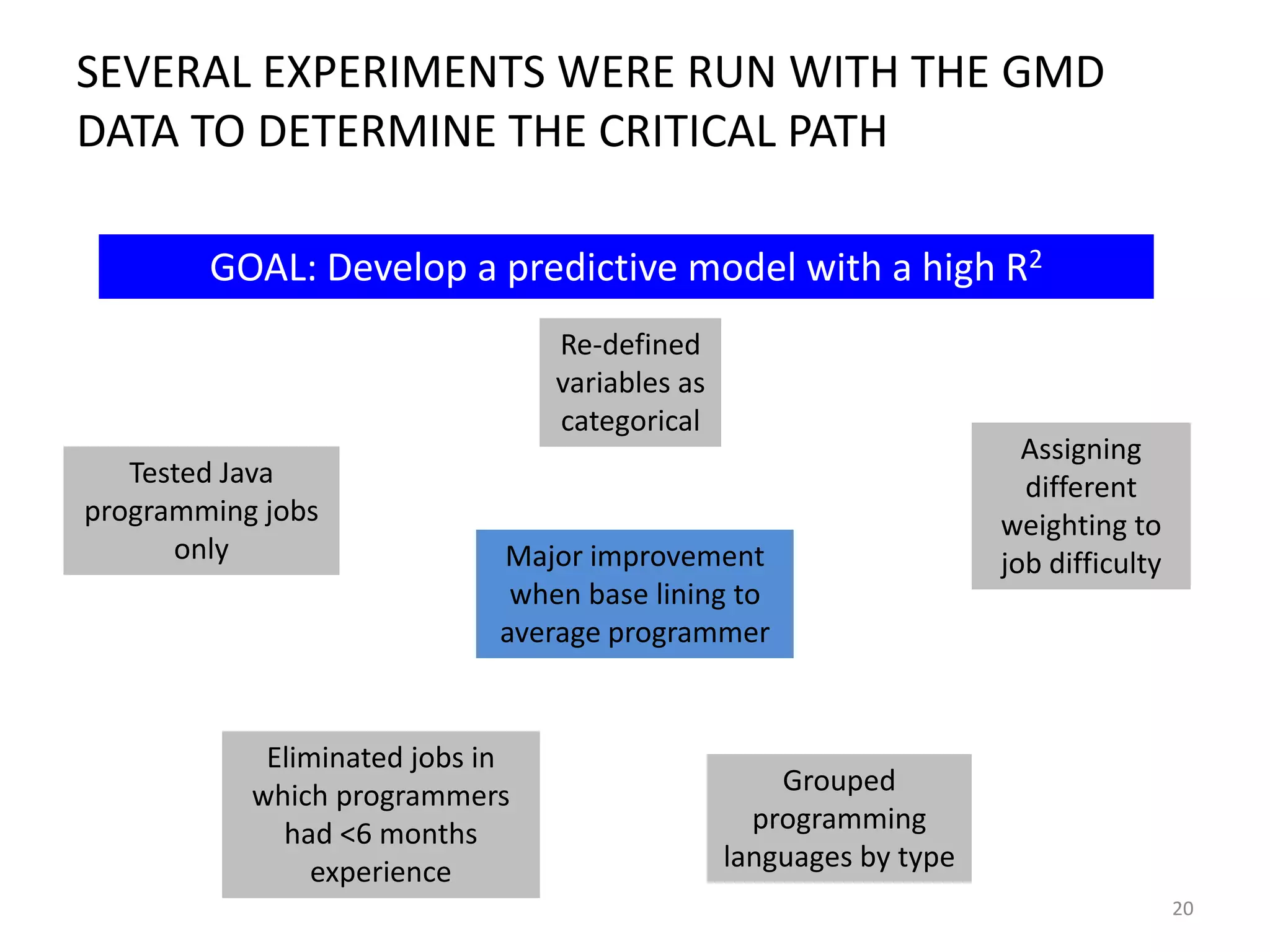

SEVERAL EXPERIMENTS WERE RUN WITH THE GMD
DATA TO DETERMINE THE CRITICAL PATH
GOAL: Develop a predictive model with a high R2
Re-defined
variables as
categorical
Tested Java
programming jobs
only

Major improvement
when base lining to
average programmer

Eliminated jobs in
which programmers
had <6 months
experience

Assigning
different
weighting to
job difficulty

Grouped
programming
languages by type
20

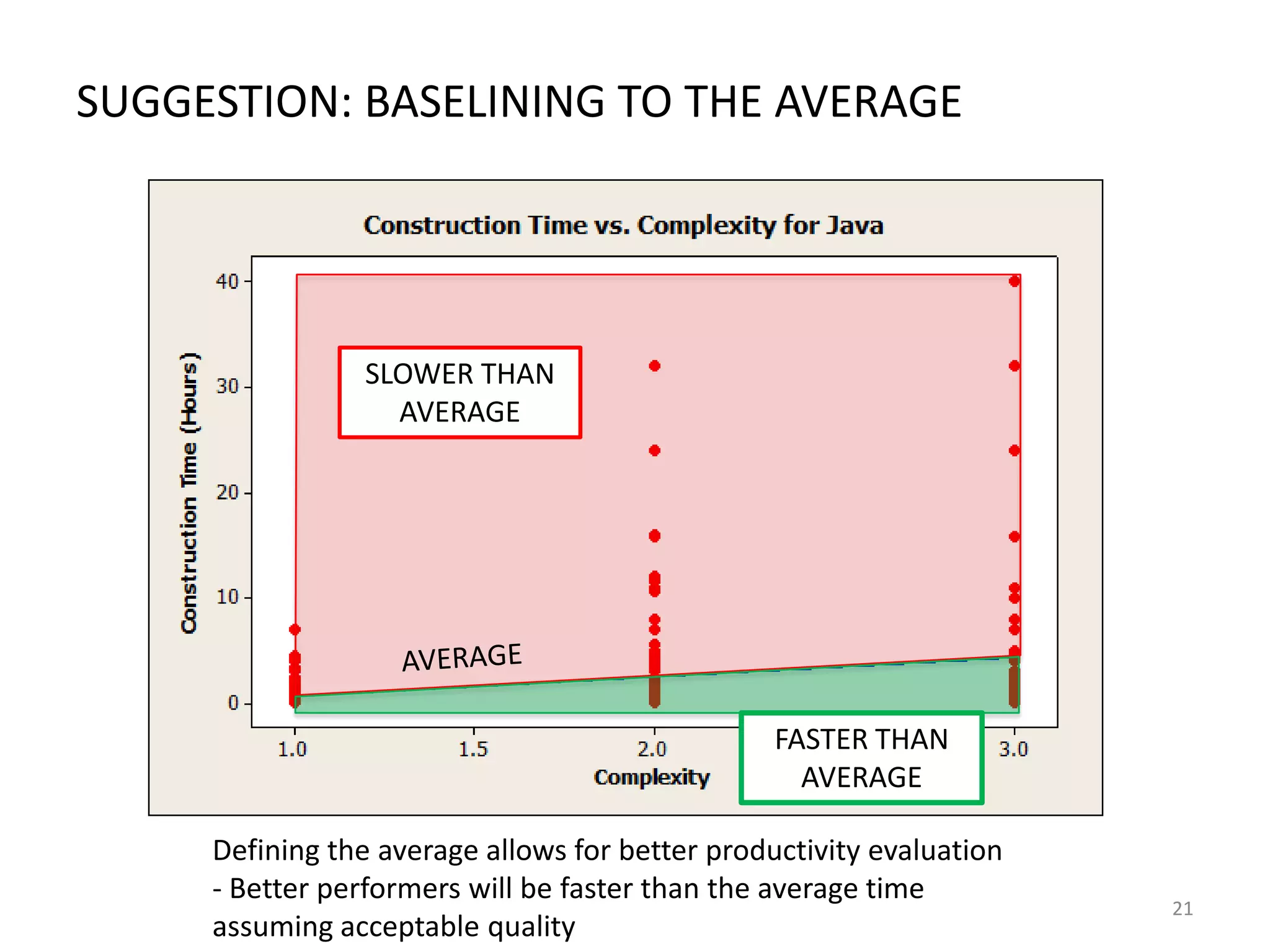

SUGGESTION: BASELINING TO THE AVERAGE

SLOWER THAN
AVERAGE

FASTER THAN
AVERAGE
Defining the average allows for better productivity evaluation
- Better performers will be faster than the average time
assuming acceptable quality

21

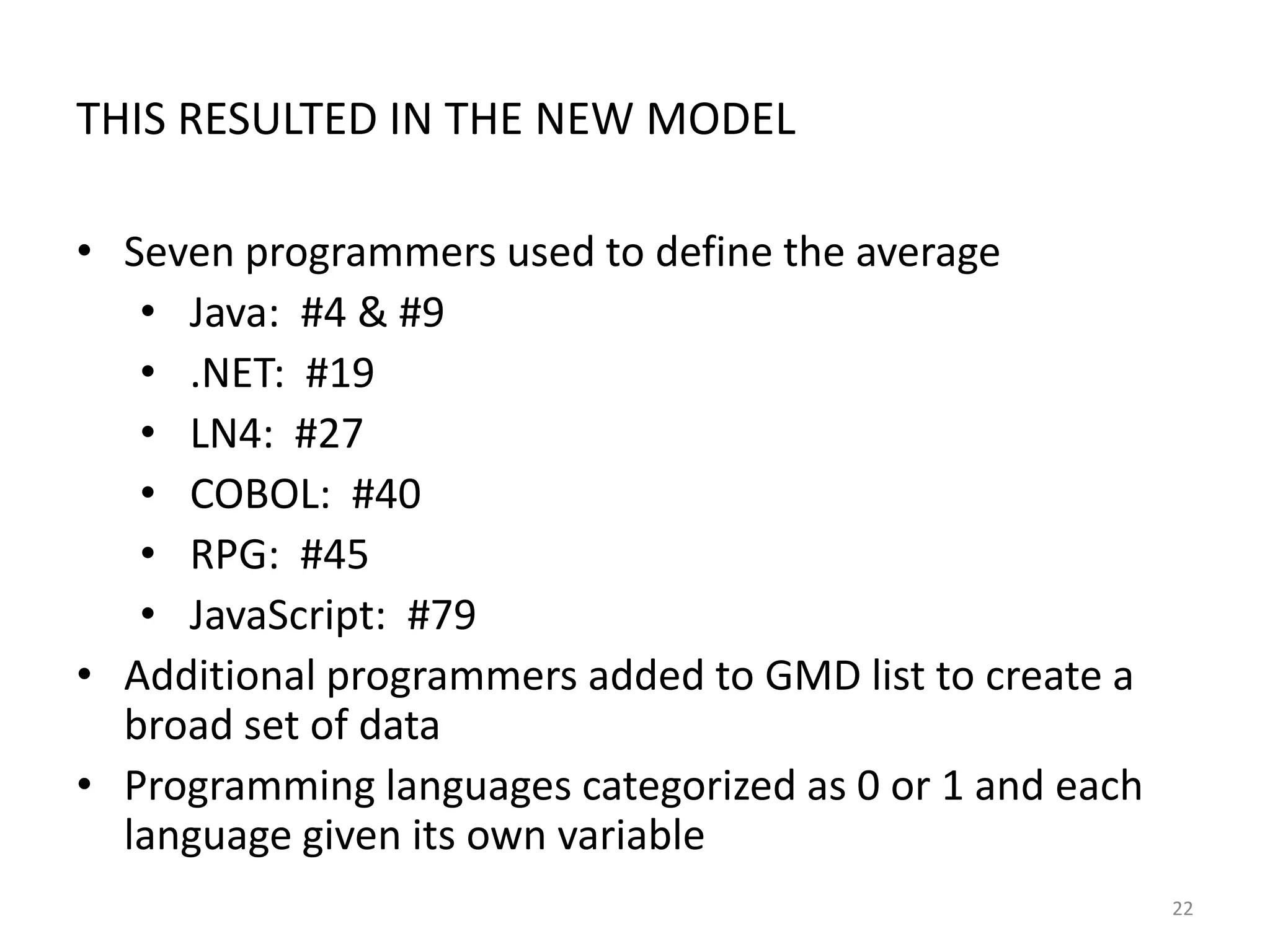

THIS RESULTED IN THE NEW MODEL
• Seven programmers used to define the average
• Java: #4 & #9
• .NET: #19
• LN4: #27
• COBOL: #40
• RPG: #45
• JavaScript: #79
• Additional programmers added to GMD list to create a
broad set of data
• Programming languages categorized as 0 or 1 and each
language given its own variable
22

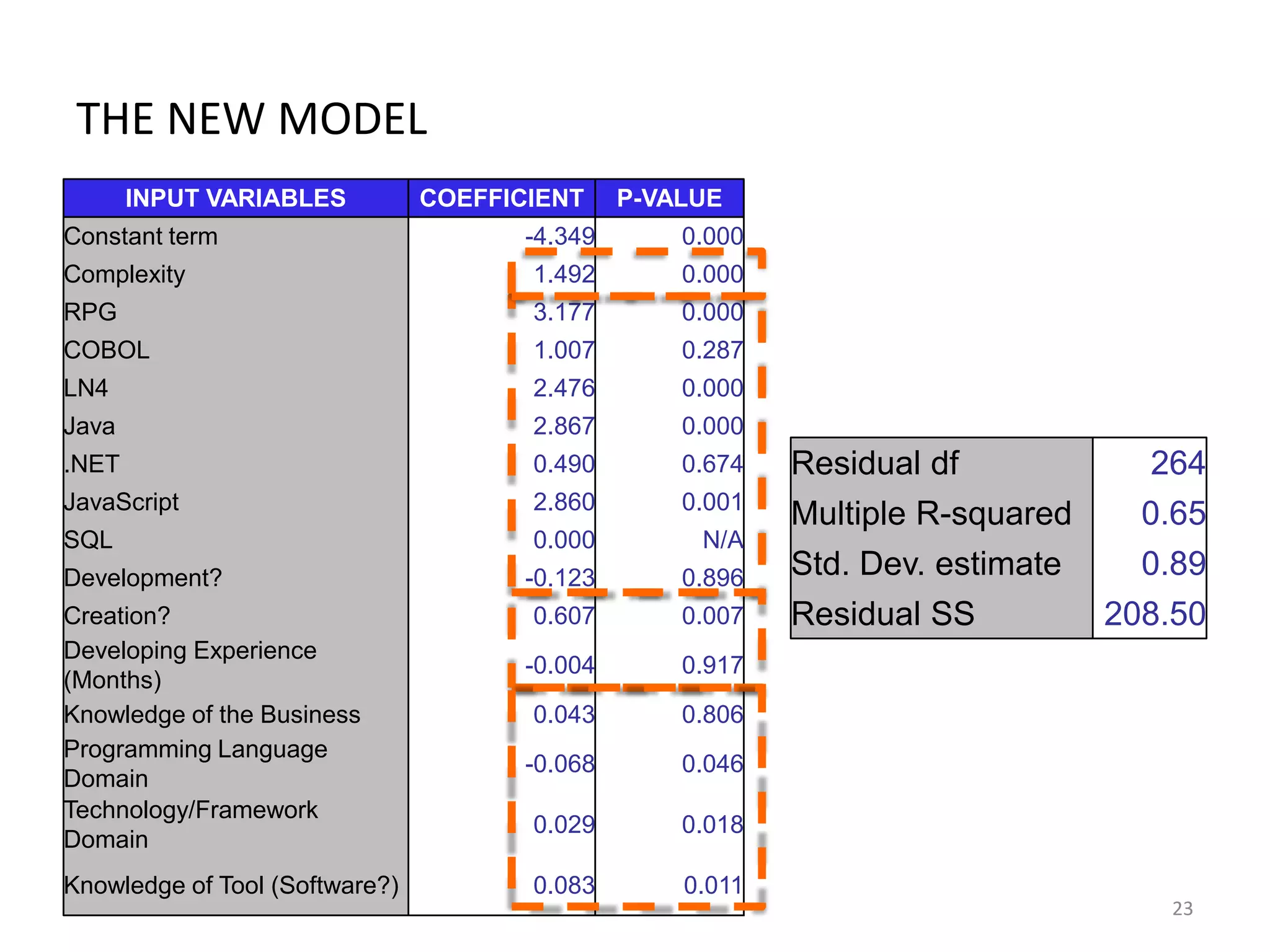

THE NEW MODEL
INPUT VARIABLES
Constant term

COEFFICIENT

P-VALUE

-4.349

0.000

Complexity

1.492

0.000

RPG

3.177

0.000

COBOL

1.007

0.287

LN4

2.476

0.000

Java

2.867

0.000

.NET

0.490

0.674

Residual df

264

JavaScript

2.860

0.001

SQL

0.000

N/A

Multiple R-squared

0.65

-0.123

0.896

Std. Dev. estimate

0.89

0.607

0.007

Residual SS

-0.004

0.917

0.043

0.806

-0.068

0.046

0.029

0.018

0.083

0.011

Development?
Creation?
Developing Experience
(Months)
Knowledge of the Business
Programming Language
Domain
Technology/Framework
Domain
Knowledge of Tool (Software?)

208.50

23

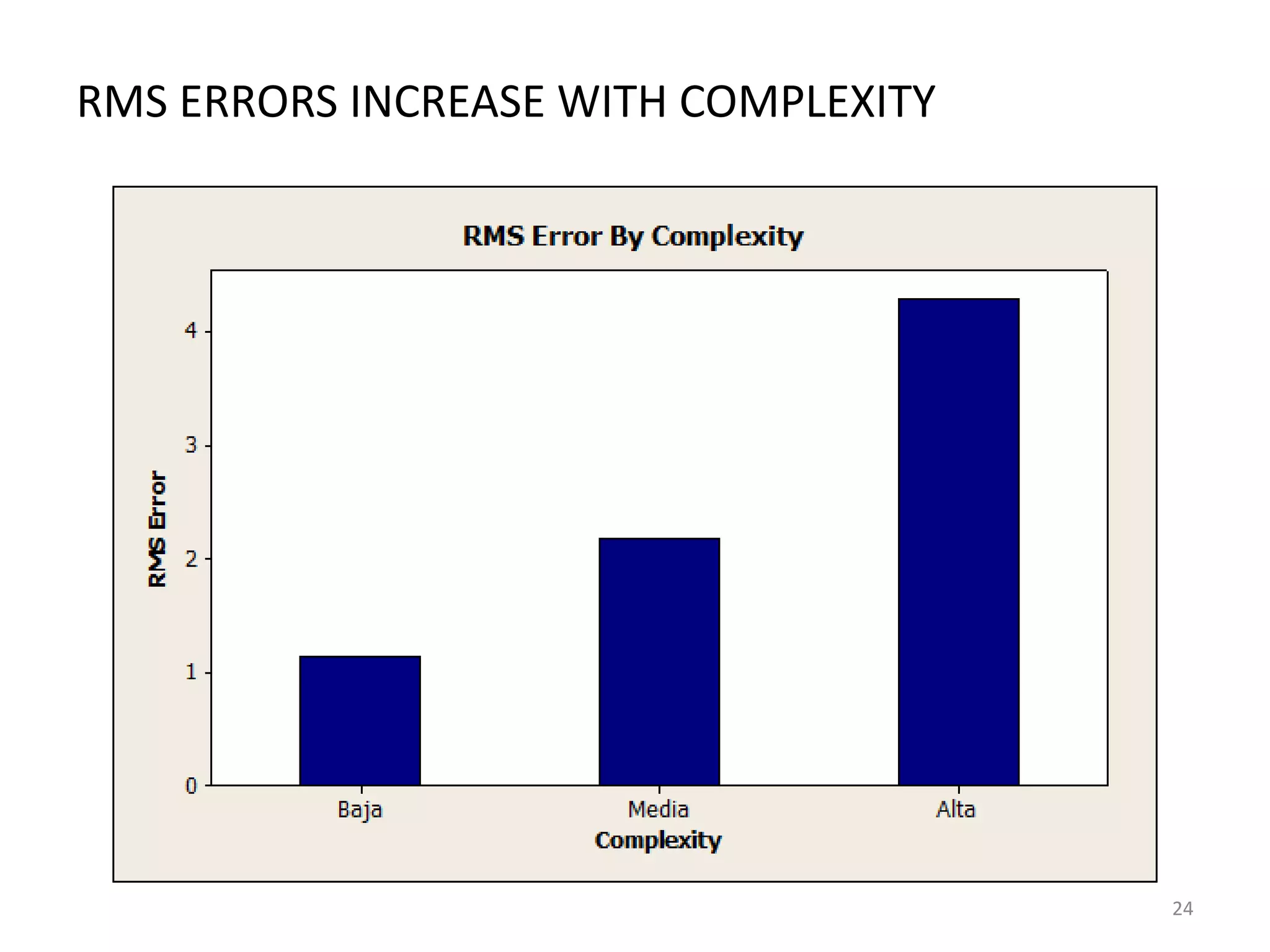

RMS ERRORS INCREASE WITH COMPLEXITY

24

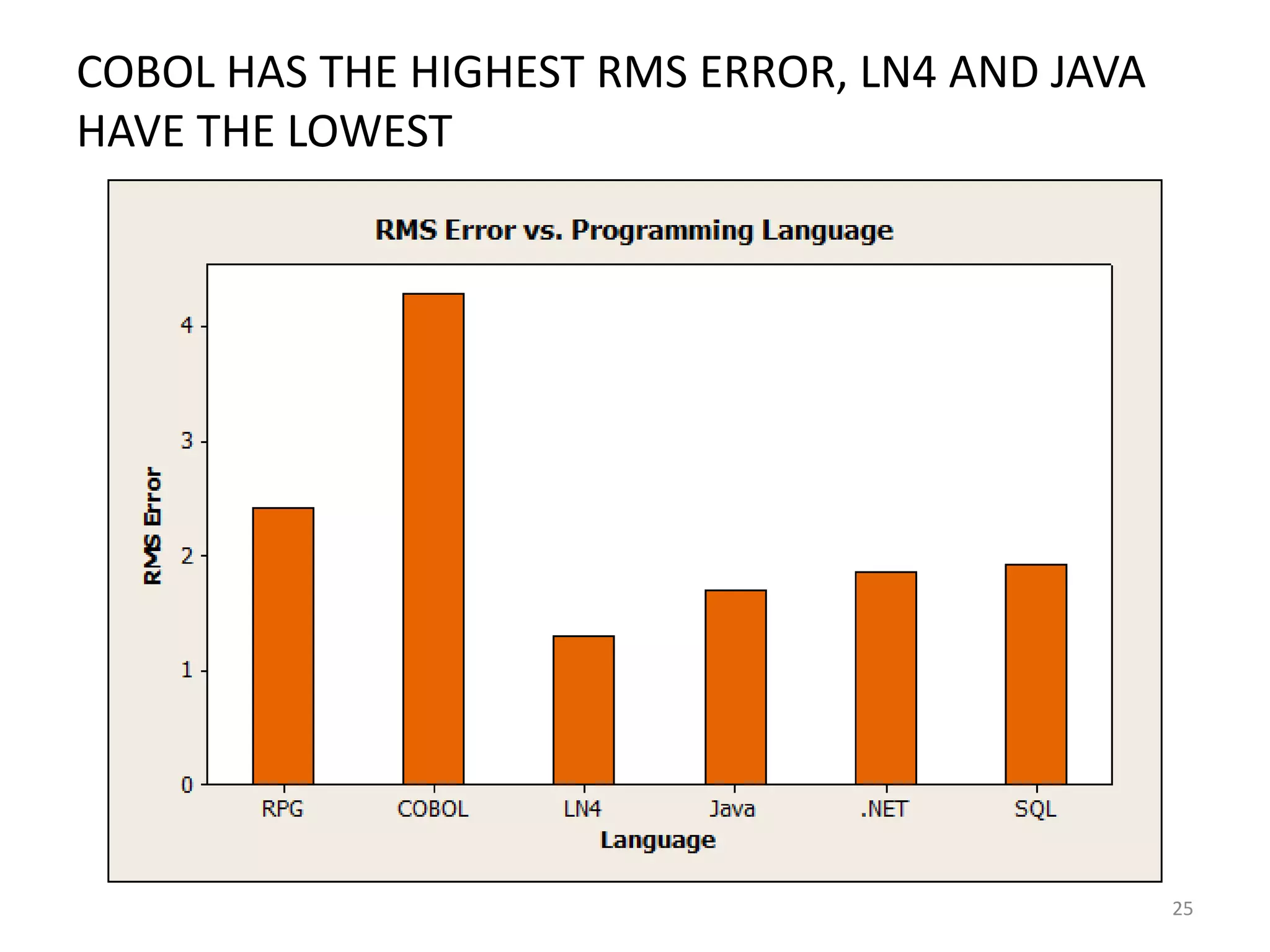

COBOL HAS THE HIGHEST RMS ERROR, LN4 AND JAVA
HAVE THE LOWEST

25
AGENDA
1 Review of Project Scope
2 Best Practices Research
3 Interview Results
4 Data Analysis and Benchmarking
5 Data Recommendations
6 Go-Forward Plan

26

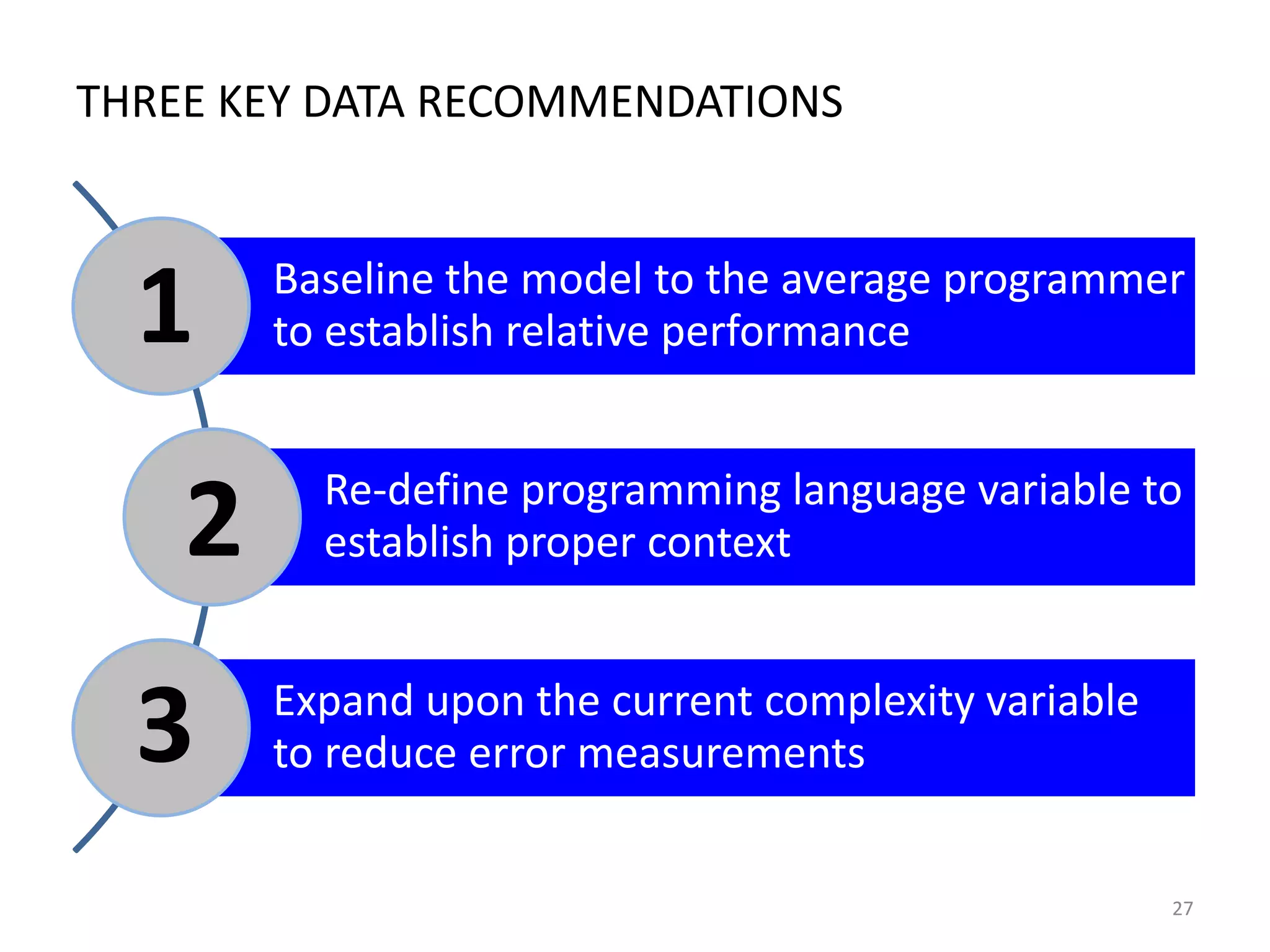

THREE KEY DATA RECOMMENDATIONS

1
2
3

Baseline the model to the average programmer
to establish relative performance
Re-define programming language variable to
establish proper context
Expand upon the current complexity variable
to reduce error measurements

27

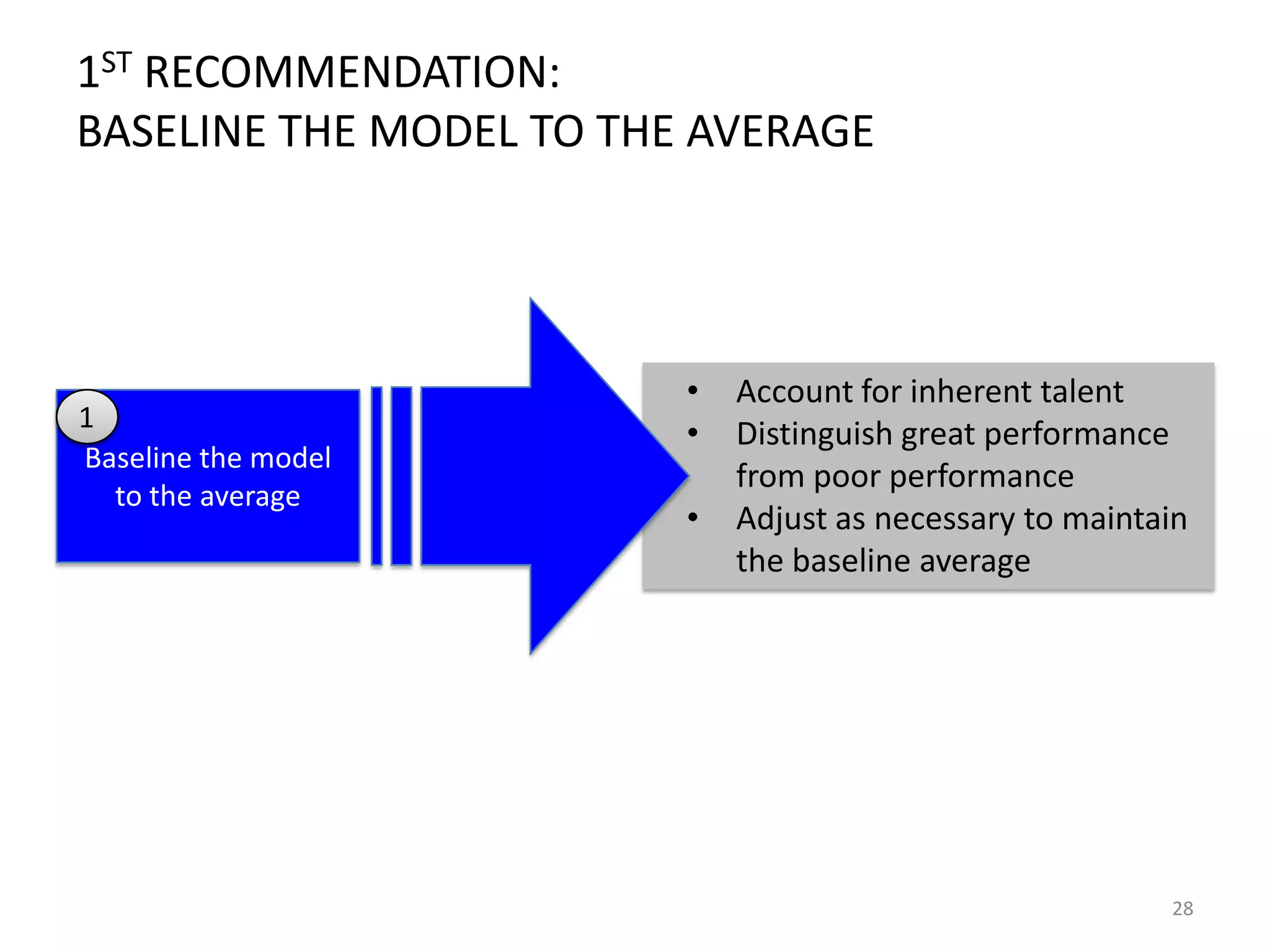

1ST RECOMMENDATION:
BASELINE THE MODEL TO THE AVERAGE

1
Baseline the model
to the average

•
•

•

Account for inherent talent
Distinguish great performance
from poor performance
Adjust as necessary to maintain
the baseline average

28
2ND RECOMMENDATION:

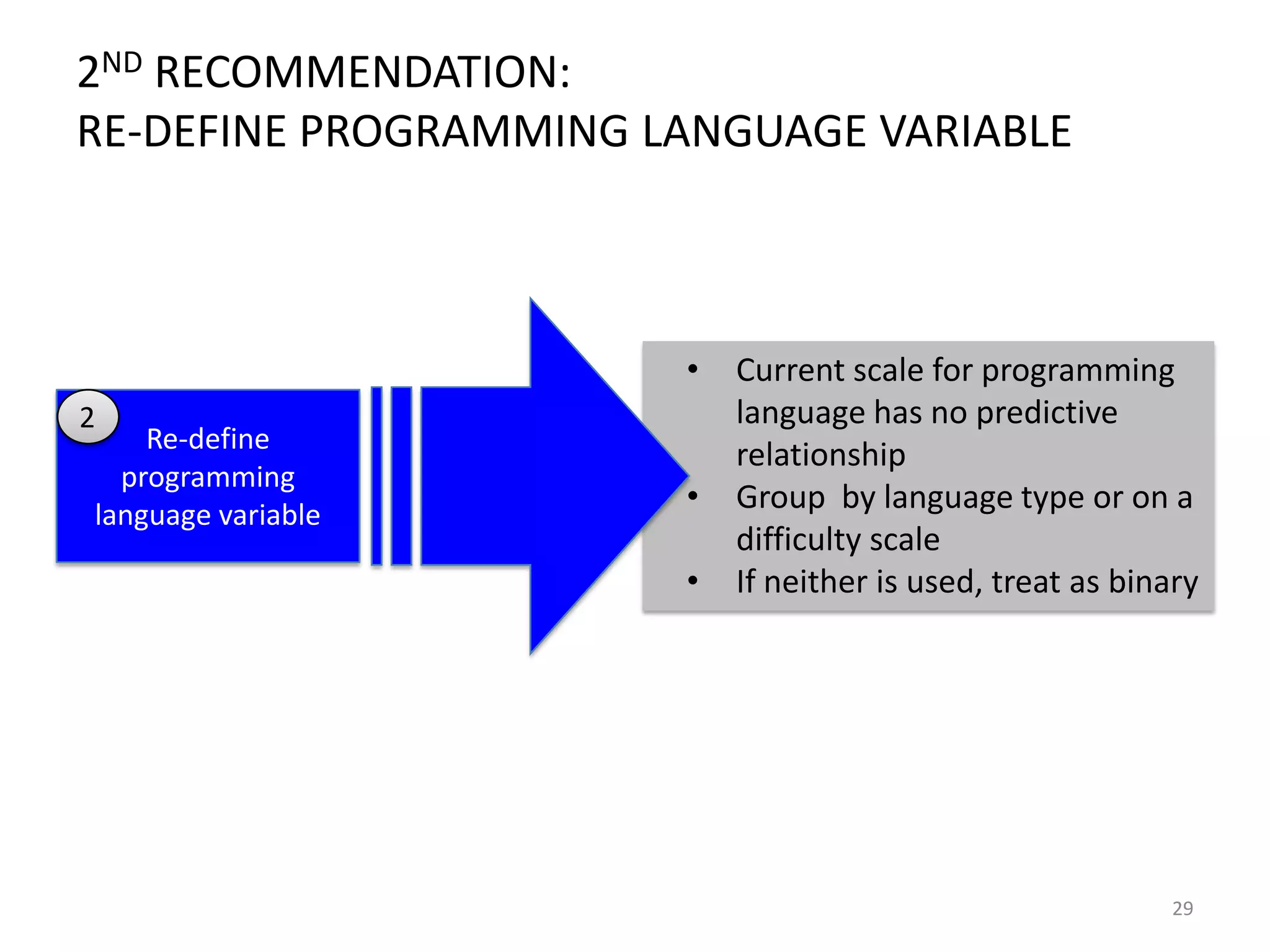

RE-DEFINE PROGRAMMING LANGUAGE VARIABLE

•
2

Re-define
programming
language variable

•
•

Current scale for programming
language has no predictive
relationship
Group by language type or on a
difficulty scale
If neither is used, treat as binary

29
3RD RECOMMENDATION:

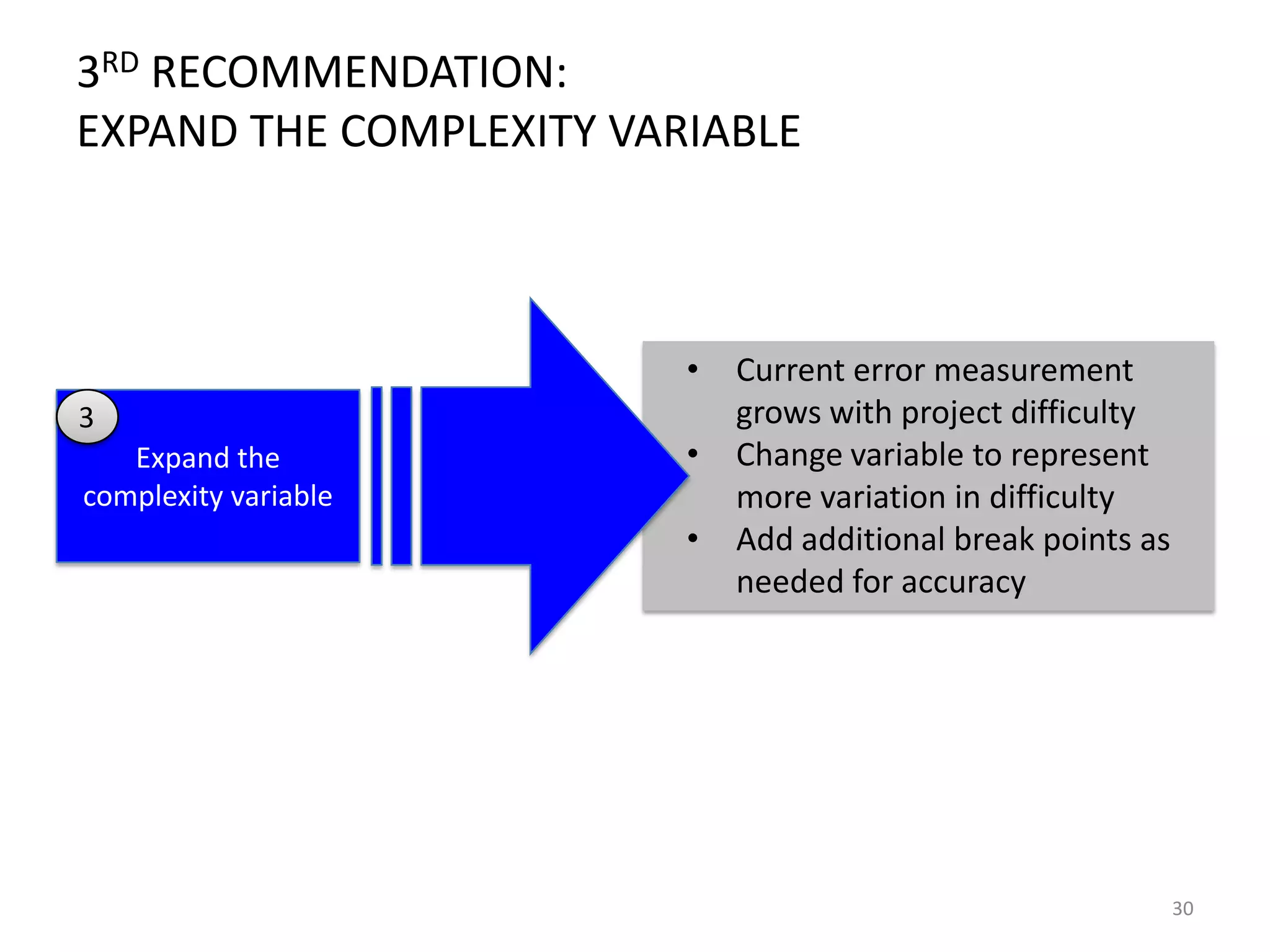

EXPAND THE COMPLEXITY VARIABLE

•
3
Expand the
complexity variable

•
•

Current error measurement
grows with project difficulty
Change variable to represent
more variation in difficulty
Add additional break points as
needed for accuracy

30

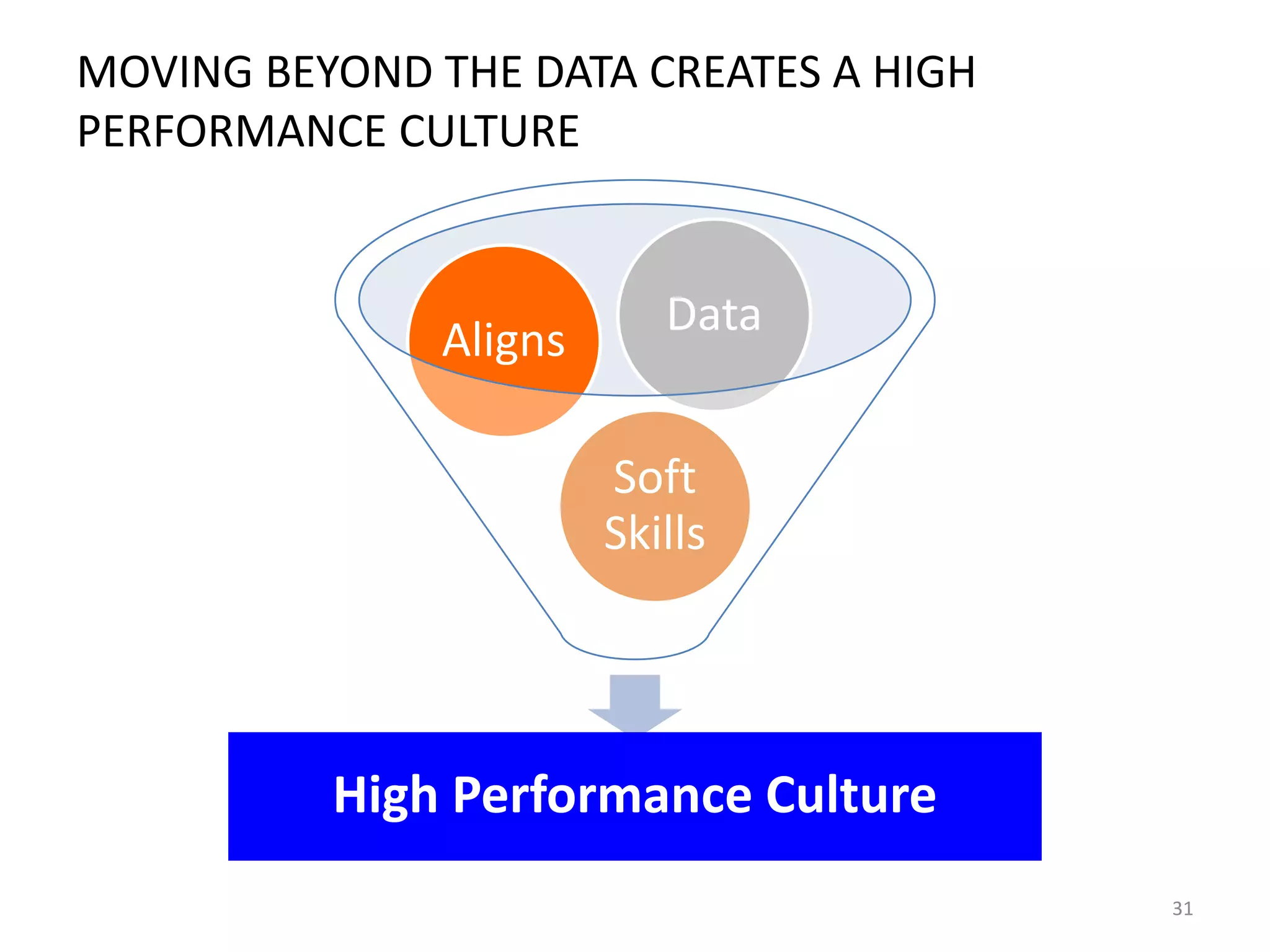

MOVING BEYOND THE DATA CREATES A HIGH
PERFORMANCE CULTURE

Aligns

Data
Soft
Skills

High Performance Culture
31
AGENDA
1 Review of Project Scope
2 Best Practices Research
3 Interview Results
4 Data Analysis and Benchmarking
5 Data Recommendations
6 Go-Forward Plan

32

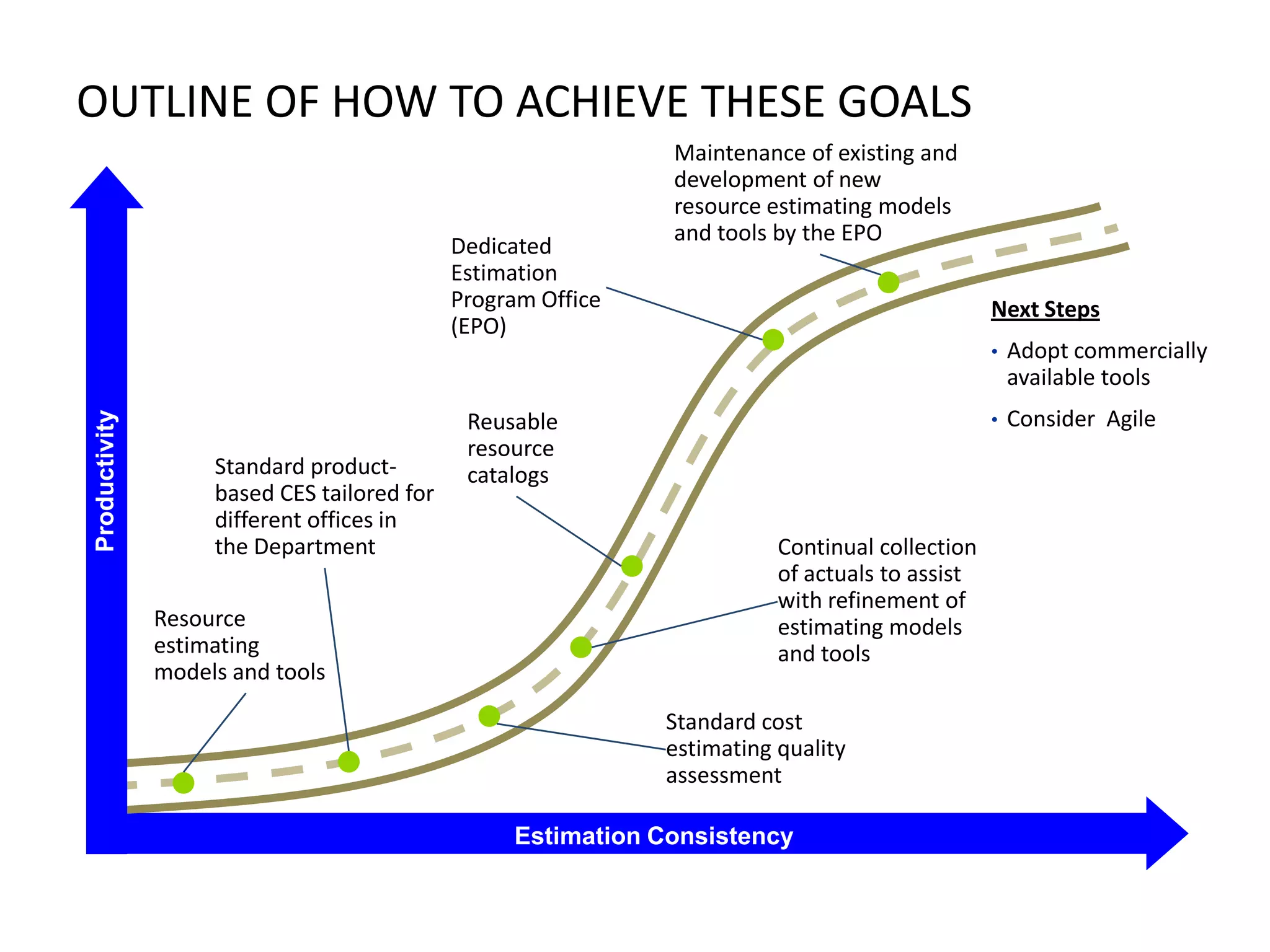

OUTLINE OF HOW TO ACHIEVE THESE GOALS
Dedicated
Estimation
Program Office
(EPO)

Maintenance of existing and
development of new
resource estimating models
and tools by the EPO
Next Steps

Productivity

•

Standard productbased CES tailored for
different offices in
the Department
Resource
estimating
models and tools

•

Reusable
resource
catalogs
Continual collection
of actuals to assist
with refinement of
estimating models
and tools
Standard cost
estimating quality
assessment
Estimation Consistency

Adopt commercially
available tools
Consider Agile

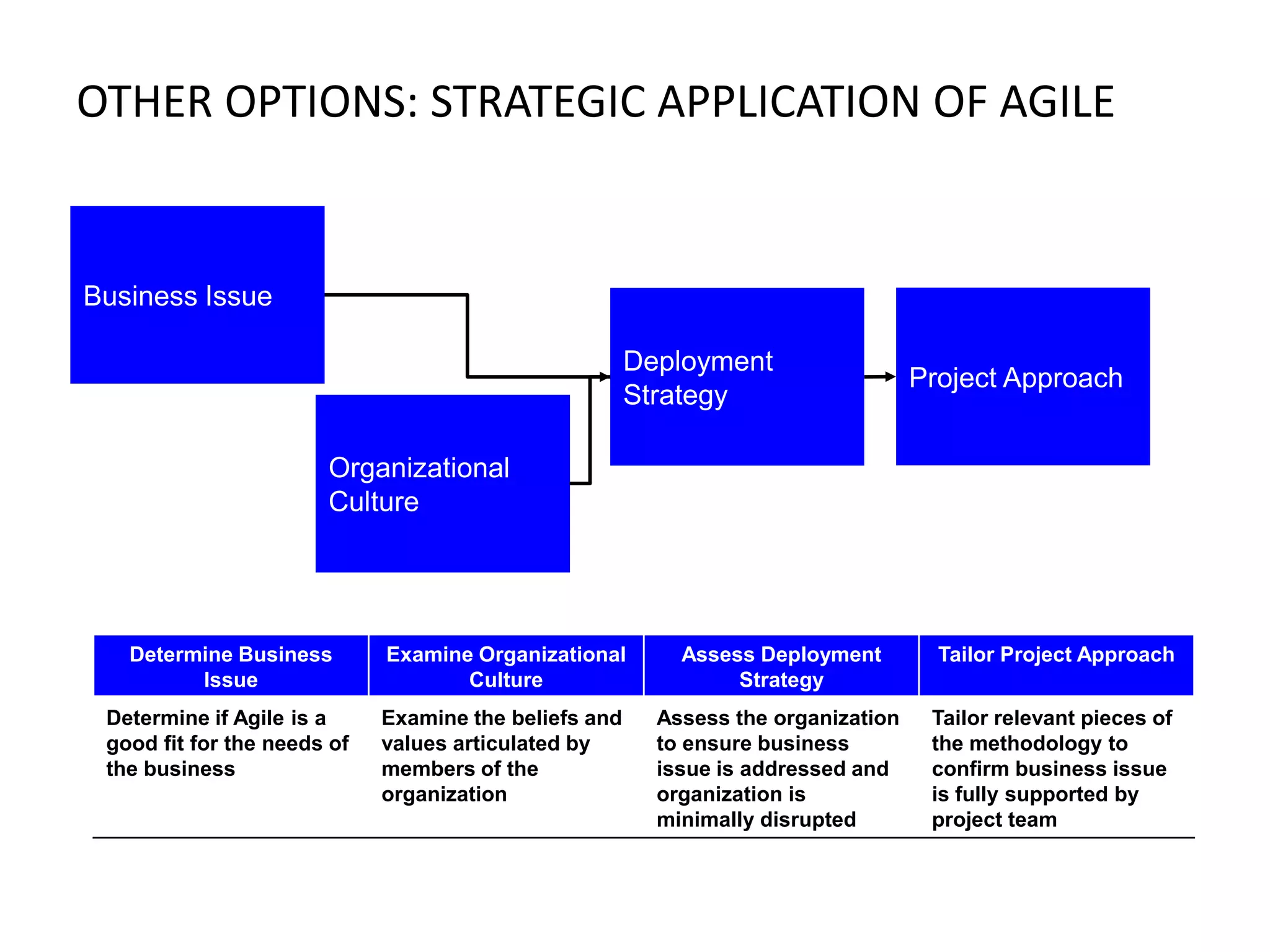

OTHER OPTIONS: STRATEGIC APPLICATION OF AGILE

Business Issue
Deployment
Strategy

Project Approach

Organizational
Culture

Determine Business
Issue

Examine Organizational
Culture

Assess Deployment
Strategy

Tailor Project Approach

Determine if Agile is a
good fit for the needs of
the business

Examine the beliefs and
values articulated by
members of the
organization

Assess the organization
to ensure business
issue is addressed and
organization is
minimally disrupted

Tailor relevant pieces of
the methodology to
confirm business issue
is fully supported by
project team

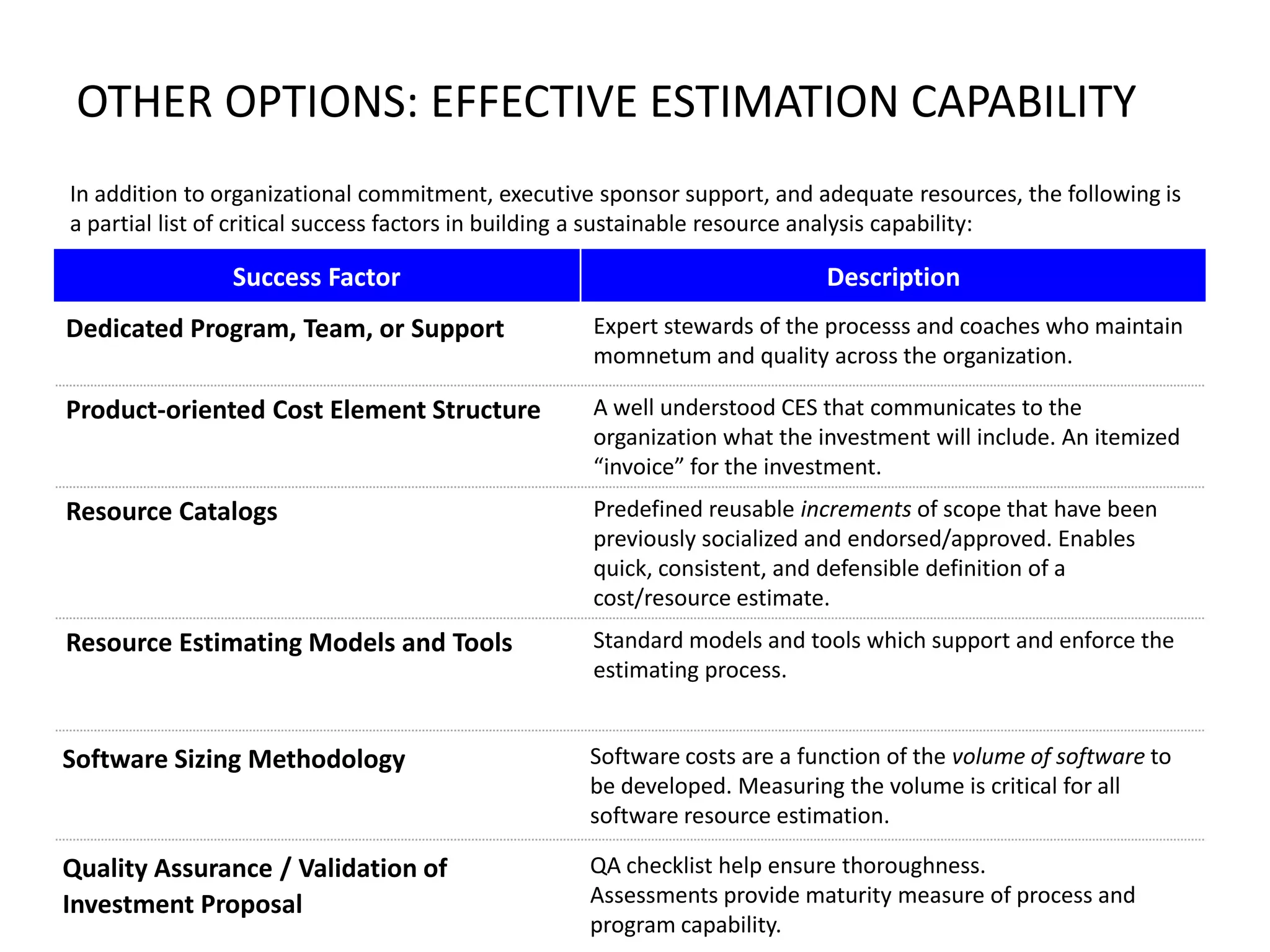

OTHER OPTIONS: EFFECTIVE ESTIMATION CAPABILITY
In addition to organizational commitment, executive sponsor support, and adequate resources, the following is
a partial list of critical success factors in building a sustainable resource analysis capability:

Success Factor

Description

Dedicated Program, Team, or Support

Expert stewards of the processs and coaches who maintain
momnetum and quality across the organization.

Product-oriented Cost Element Structure

A well understood CES that communicates to the
organization what the investment will include. An itemized
“invoice” for the investment.

Resource Catalogs

Predefined reusable increments of scope that have been
previously socialized and endorsed/approved. Enables
quick, consistent, and defensible definition of a
cost/resource estimate.

Resource Estimating Models and Tools

Standard models and tools which support and enforce the
estimating process.

Software Sizing Methodology

Software costs are a function of the volume of software to
be developed. Measuring the volume is critical for all
software resource estimation.

Quality Assurance / Validation of
Investment Proposal

QA checklist help ensure thoroughness.
Assessments provide maturity measure of process and
program capability.

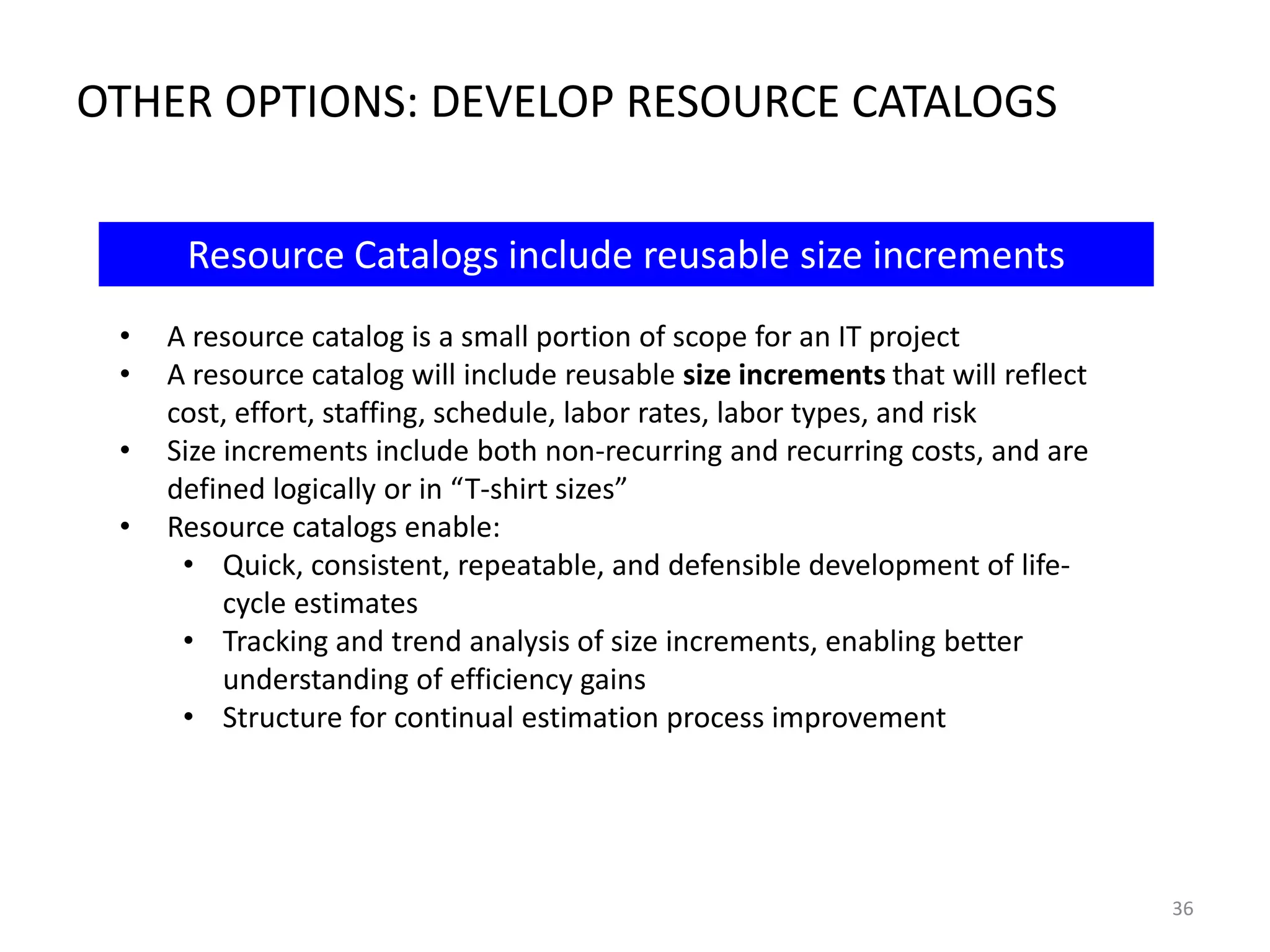

OTHER OPTIONS: DEVELOP RESOURCE CATALOGS
Resource Catalogs include reusable size increments
•
•
•
•

A resource catalog is a small portion of scope for an IT project
A resource catalog will include reusable size increments that will reflect
cost, effort, staffing, schedule, labor rates, labor types, and risk
Size increments include both non-recurring and recurring costs, and are
defined logically or in “T-shirt sizes”
Resource catalogs enable:
• Quick, consistent, repeatable, and defensible development of lifecycle estimates
• Tracking and trend analysis of size increments, enabling better
understanding of efficiency gains
• Structure for continual estimation process improvement

36

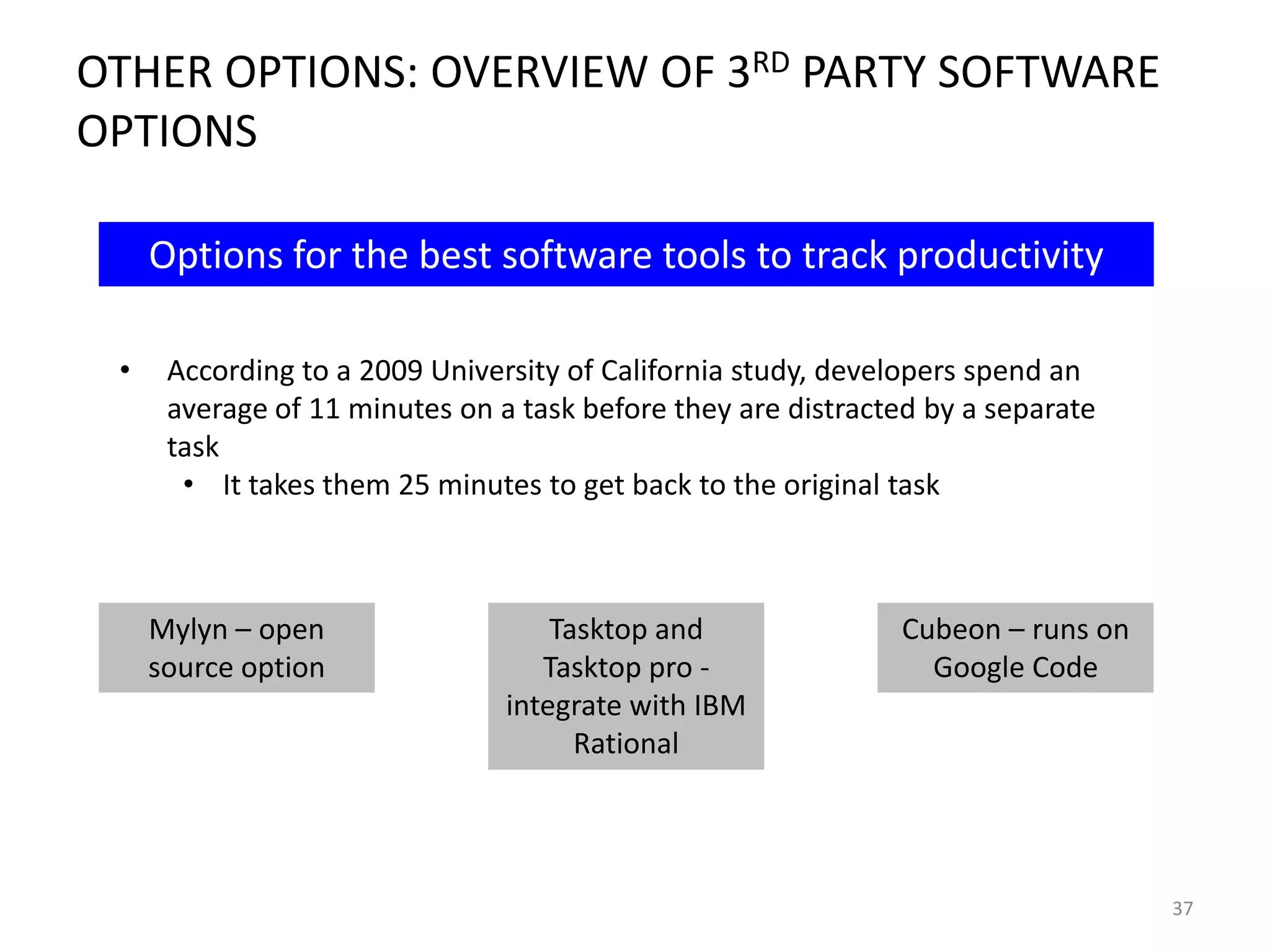

OTHER OPTIONS: OVERVIEW OF 3RD PARTY SOFTWARE
OPTIONS
Options for the best software tools to track productivity
•

According to a 2009 University of California study, developers spend an
average of 11 minutes on a task before they are distracted by a separate
task
• It takes them 25 minutes to get back to the original task

Mylyn – open
source option

Tasktop and
Tasktop pro integrate with IBM
Rational

Cubeon – runs on
Google Code

37

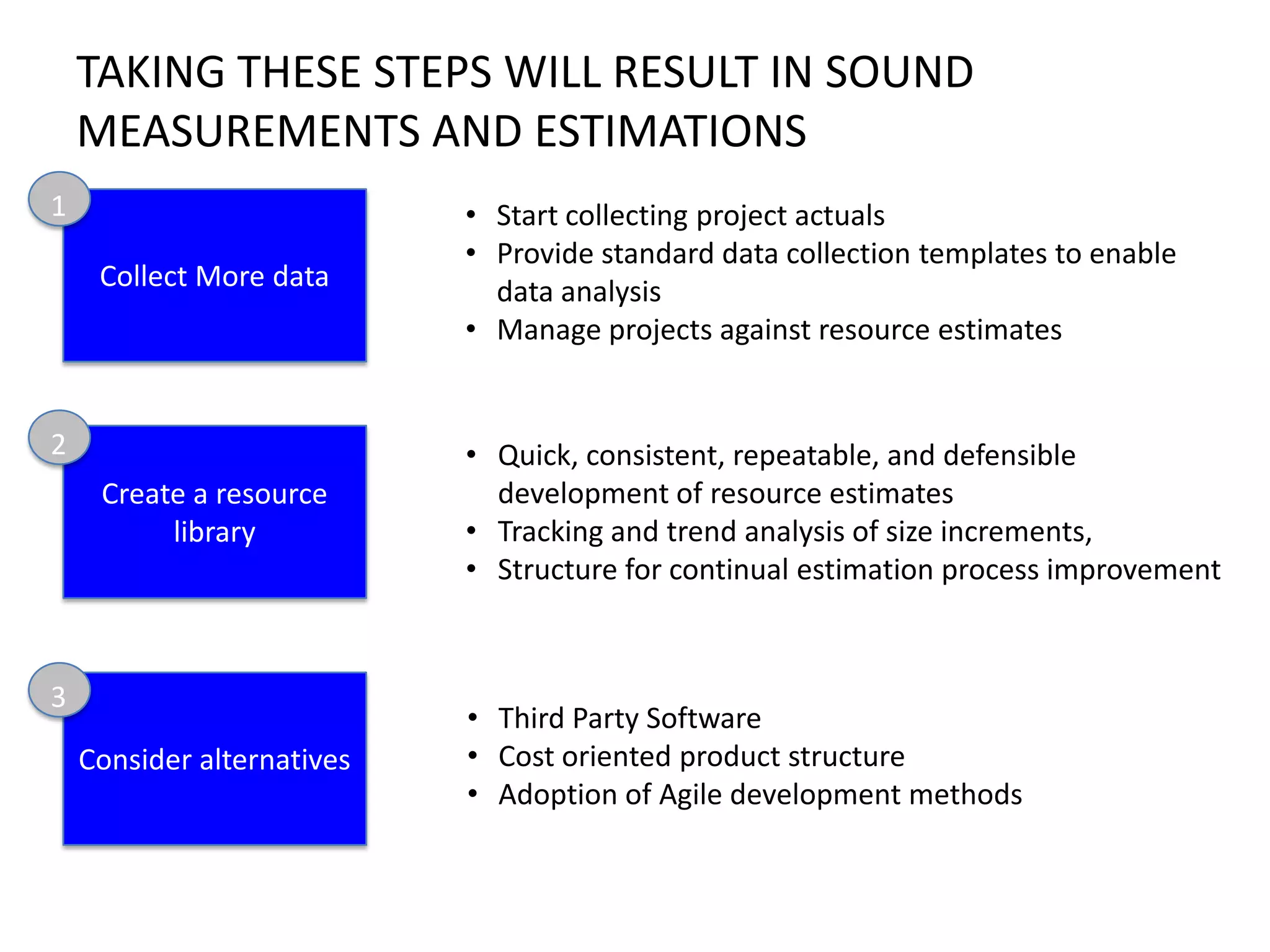

TAKING THESE STEPS WILL RESULT IN SOUND
MEASUREMENTS AND ESTIMATIONS
1
Collect More data

• Start collecting project actuals
• Provide standard data collection templates to enable
data analysis
• Manage projects against resource estimates

Create a resource
library

• Quick, consistent, repeatable, and defensible
development of resource estimates
• Tracking and trend analysis of size increments,
• Structure for continual estimation process improvement

2

3
Consider alternatives

• Third Party Software
• Cost oriented product structure
• Adoption of Agile development methods
Gracias!

39
Appendix

40
WE REVIEWED RESEARCH FROM MULTIPLE SOURCES
Sample Works Reviewed:
Measuring Developers, Aligning Perspectives and other Best Practices by Medha
Umarji and Forrest Shull published in the IEEE Software Journal in 2009
The Futility of Developer Productivity Metrics by Neil Mcallister November 17, 2011
http://www.infoworld.com/d/application-development/the-futility-developerproductivity-metrics-179244

Five Requirements for Measuring Application Quality by Jitendra Subramanyam,
director of research, CAST Inc. June 17, 2011
http://www.networkworld.com/news/tech/2011/061611-application-quality.html
Establishing a Measurement Program, Whitepaper by the Construx Staff

41

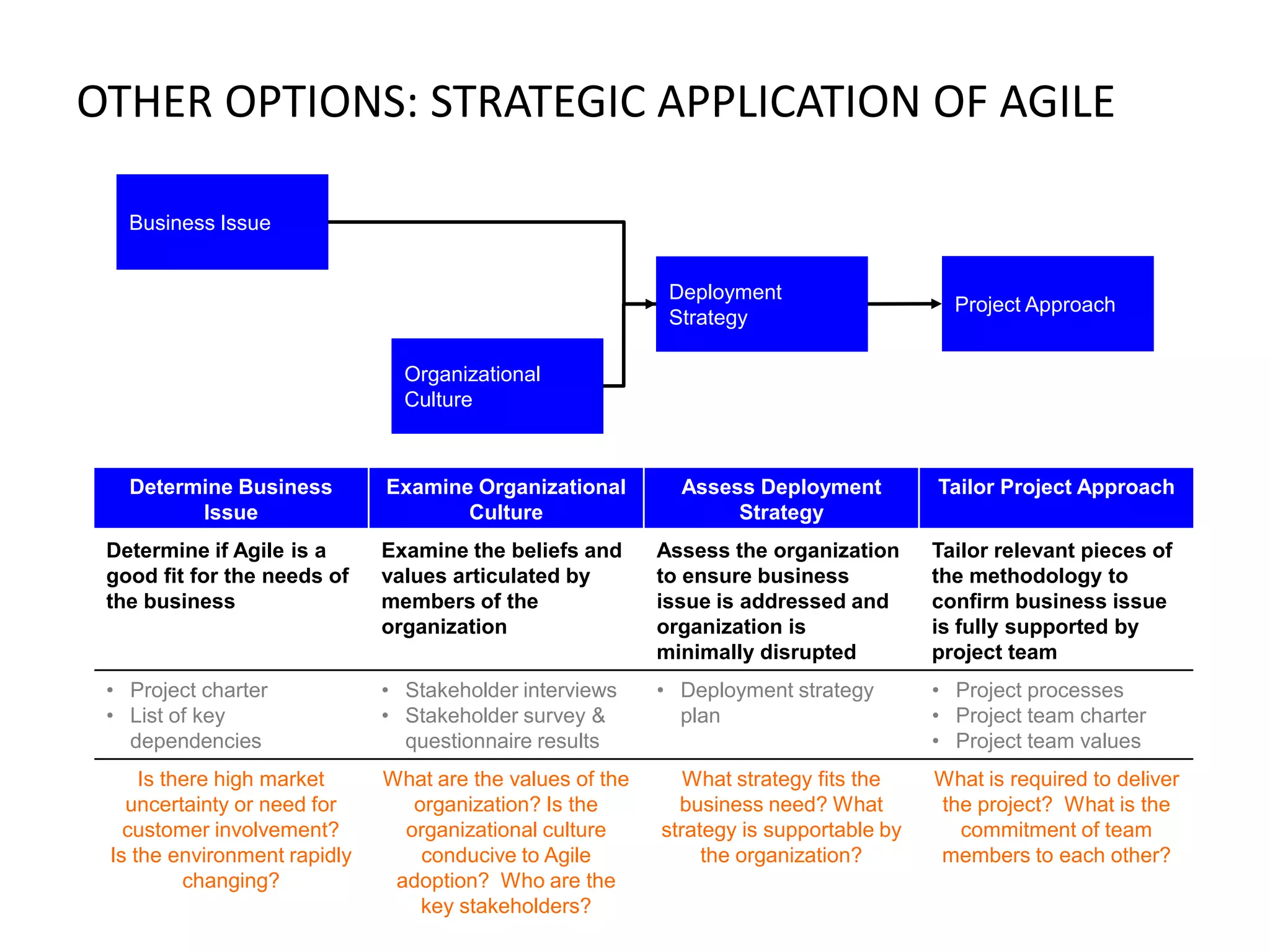

OTHER OPTIONS: STRATEGIC APPLICATION OF AGILE
Business Issue
Deployment
Strategy

Project Approach

Organizational
Culture

Determine Business
Issue

Examine Organizational
Culture

Assess Deployment
Strategy

Tailor Project Approach

Determine if Agile is a
good fit for the needs of
the business

Examine the beliefs and
values articulated by
members of the
organization

Assess the organization
to ensure business
issue is addressed and
organization is
minimally disrupted

Tailor relevant pieces of
the methodology to
confirm business issue
is fully supported by
project team

• Project charter
• List of key
dependencies

• Stakeholder interviews
• Stakeholder survey &
questionnaire results

• Deployment strategy
plan

• Project processes
• Project team charter
• Project team values

Is there high market
uncertainty or need for
customer involvement?
Is the environment rapidly
changing?

What are the values of the
organization? Is the
organizational culture
conducive to Agile
adoption? Who are the
key stakeholders?

What strategy fits the
business need? What
strategy is supportable by
the organization?

What is required to deliver
the project? What is the
commitment of team
members to each other?
SEVERAL EXPERIMENTS WERE RUN WITH THE GMD
DATA
• Different methods were attempted to achieve a higher R2 for the
predictive model
• Re-defined variables as categorical
•Assigned different weighting to job difficulty
• Tested Java programming jobs only
• Grouped programming languages by type
• Eliminated jobs in which programmers had <6 months experience
•High variability
• Also experimented with other data mining approaches other than
multiple linear regression
• Regression trees
•Good results (Lower RMS Error), not precise enough for GMD
• Principal Components Analysis
• Major improvement when base lining to average programmer

43

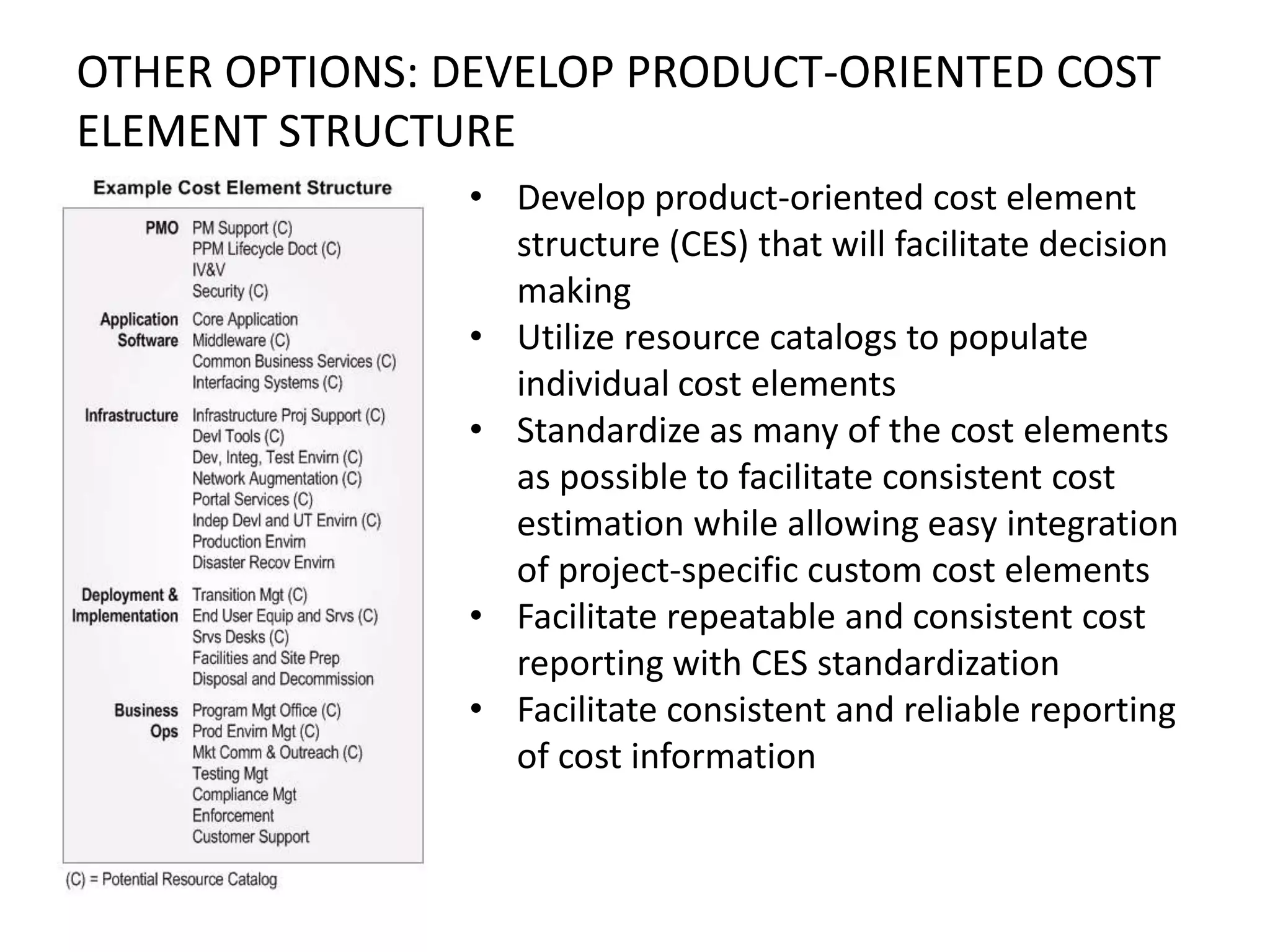

OTHER OPTIONS: DEVELOP PRODUCT-ORIENTED COST
ELEMENT STRUCTURE
• Develop product-oriented cost element
structure (CES) that will facilitate decision
making
• Utilize resource catalogs to populate
individual cost elements
• Standardize as many of the cost elements
as possible to facilitate consistent cost
estimation while allowing easy integration
of project-specific custom cost elements
• Facilitate repeatable and consistent cost
reporting with CES standardization
• Facilitate consistent and reliable reporting
of cost information

Benchmarking Software Estimation Methods

  • 1.
    Benchmarking Software Estimation Methods AdamBoyd, Sameer Huque, Kristine Pachuta, Travis Pincoski, John Trumble July 11, 2013 1
  • 2.
    • Product Directorat Bloomberg LP • Former IT Sourcing Director at Bloomberg and Pricing Analyst at General Dynamics OUR TEAM • Sr. Education Associate at the American Chemical Society Kristine Adam • Mechanical Engineer at US Bureau of Engraving & Printing • Sr. Consultant at Deloitte Consulting LLP Travis • Senior Financial Planning Analyst at BAE Systems Sameer John 2
  • 3.
    AGENDA 1 Review ofProject Scope 2 Best Practices Research 3 Interview Results 4 Data Analysis and Benchmarking 5 Data Recommendations 6 Go-Forward Plan 3
  • 4.
    OUR PROJECT SCOPECOVERED BEST PRACTICE RESEARCH AND DATA BENCHMARKING PROJECT SCOPE • Compile a list of software estimation methods, best practices and benchmarks used at competing firms in US • Analyze GMD data and summarize findings • Analyze third party data • Present data and suggestions to GMD project sponsors 4
  • 5.
    OUR RECOMMENDATIONS AREBASED ON THE RESULTS OF OUR RESEARCH AND ANALYSIS 1 Researched Industry Best Practices 2 • Searched Industry Journals • Comprehensive News Searches • Established Summaries Interviewed Subject Matter Experts • Interviewed experts across the industry • Used standardized questions • Established Summaries Analyzed Available Data • Analyzed GMD provided data • Analyzed third party data • Established Equation and Recommendations Formulated Recommendations • Compiled themes across all research areas • Formulated the data model • Delivered multiple options for recommendations 3 4 5
  • 6.
    A ROADMAP OFINCREMENTAL IMPROVEMENTS WILL HELP YOU MEET YOUR GOALS Productivity Support timely and effective estimates, bug fixes and re-work Continually improve the consistency, reliabi lity and productivity of your developers and the data and resources to track and estimate Build and deploy in-house estimating and productivity planning capability Support consistent and reliable project planning Estimation Consistency
  • 7.
    AGENDA 1 Review ofProject Scope 2 Best Practices Research 3 Interview Results 4 Data Analysis and Benchmarking 5 Data Recommendations 6 Go-Forward Plan 7
  • 8.
    SEVERAL THEMES EMERGEDIN OUR RESEARCH OF BEST PRACTICES Theme Research The best measurements are quantitative and qualitative • Data should be refined and measured • Data analysis should be coupled with soft skills analysis • The best developers may not make the best leaders • Measures are best used in large distributed projects ---------------------------------------------------------------------------------------------------------------Some data is easy to game • Metrics like lines of code are easy to trick • Mentoring or leading projects may result in low metrics • Refactoring or documenting are often not accounted ---------------------------------------------------------------------------------------------------------------• Metrics should not be used punitively Metrics can be • Comparing across projects is difficult and possibly inaccurate de-motivating • Project managers, not management should control
  • 9.
    DATA MODELS SHOULDHAVE FIVE KEY CHARACTERISTICS Breadth Depth Explicit Actionable Automated To handle multiple technologies To looks at all levels of the application Enough to test against industry standards To show where improvements can be made To not detract from the workload
  • 10.
    TECHNICAL GOALS SHOULDALIGN WITH YOUR CORPORATE AND STRATEGIC GOALS Technical Goals Software Quality Developer Efficiency Customer Satisfaction Strategic Goals Product Quality On Time Delivery Customer Satisfaction Corporate Goals Quality Efficiency Customer Satisfaction 10
  • 11.
    AGENDA 1 Review ofProject Scope 2 Best Practices Research 3 Interview Results 4 Data Analysis and Benchmarking 5 Data Recommendations 6 Go-Forward Plan 11
  • 12.
    WE INTERVIEWED MANYINDUSTRY EXPERTS Chief Information Officer, Philips IT Size Head of Digital Content Development, AOL Director, Thoughtworks Consulting Chief Technologist, SWComplete Co-Director, Security and Software Engineering Research Center Georgetown University Consulting Academia Government Business Sector Corporate 12
  • 13.
    THE EXPERTS HAVESTRONG OPINIONS ABOUT THE NECESSITY OF MEASURING DEVELOPER OUTPUT most formal measurement systems may de-motivate developers identify the developer that other developers go to for advice we don't base pay or increase on development metrics at all a great developer will have vocal ideas about changing things AND make it happen peer code review is key 13
  • 14.
    MOST EXPERTS STRESSEDTHE DIFFICULTY OF MEASUREMENT (1) Interviewee Co-Director, Security and Software Engineering Research Center, Georgetown University Key Takeaways lines of code per day delivered (debugged) best metric but backward looking function point analysis allows interoperability but no consensus on translation evaluations must account for code complexity Chief Technologist, SWComplete soft skills (communication, attention to detail) equally important to quality peer evaluations critical component of developer evaluation important not to penalize developers for taking time to exceed expectations 14
  • 15.
    MOST EXPERTS STRESSEDTHE DIFFICULTY OF MEASUREMENT (2) Interviewee Former Head, AOL Digital Content Development Key Takeaways difficult to disaggregate contributions of individual team members leadership important but hard to quantify how to quantify extensibility of code? CIO, Philips IT look at teams not individuals track what and how — both equally important Director, Thoughtworks Consulting poor developers will always be exposed regardless of measurement estimations should be done with input from multiple developers 15
  • 16.
    ONLY ONE OFTHE COMPANIES WE INTERVIEWED MEASURES INDIVIDUAL DEVELOPER PRODUCTIVITY Measures Productivity Do Not Measure Productivity 16
  • 17.
    AGENDA 1 Review ofProject Scope 2 Best Practices Research 3 Interview Results 4 Data Analysis and Benchmarking 5 Data Recommendations 6 Go-Forward Plan 17
  • 18.
    WE CONDUCTED ANANALYSIS OF THE GMD PROVIDED DATA SET Approach 1 •Comparison of GMD data to data from ISBSG (International Software Benchmarking Standards Group) •Research to see what other metrics may be tracked Approach 2 •Analysis of GMD regression model and raw data Outcome Combined best practices found in research with experimental work done with GMD data to determine best recommendation for productivity measurements moving forward •Re-define existing variables •Experiment with new approaches 18
  • 19.
    WE ALSO CONDUCTEDAN ANALYSIS OF A THIRD PARTY DATASET GOAL: Benchmark GMD data to an independent data set •Sample data set obtained from ISBSG •ISBSG tracked roughly thirty different metrics in estimation •They tracked many similar variables •Task type (creation/modification) •Language and standards used •They also tracked a few items that may be helpful to GMD in the future •Job Size •Quantity of defects 19
  • 20.
    SEVERAL EXPERIMENTS WERERUN WITH THE GMD DATA TO DETERMINE THE CRITICAL PATH GOAL: Develop a predictive model with a high R2 Re-defined variables as categorical Tested Java programming jobs only Major improvement when base lining to average programmer Eliminated jobs in which programmers had <6 months experience Assigning different weighting to job difficulty Grouped programming languages by type 20
  • 21.
    SUGGESTION: BASELINING TOTHE AVERAGE SLOWER THAN AVERAGE FASTER THAN AVERAGE Defining the average allows for better productivity evaluation - Better performers will be faster than the average time assuming acceptable quality 21
  • 22.
    THIS RESULTED INTHE NEW MODEL • Seven programmers used to define the average • Java: #4 & #9 • .NET: #19 • LN4: #27 • COBOL: #40 • RPG: #45 • JavaScript: #79 • Additional programmers added to GMD list to create a broad set of data • Programming languages categorized as 0 or 1 and each language given its own variable 22
  • 23.
    THE NEW MODEL INPUTVARIABLES Constant term COEFFICIENT P-VALUE -4.349 0.000 Complexity 1.492 0.000 RPG 3.177 0.000 COBOL 1.007 0.287 LN4 2.476 0.000 Java 2.867 0.000 .NET 0.490 0.674 Residual df 264 JavaScript 2.860 0.001 SQL 0.000 N/A Multiple R-squared 0.65 -0.123 0.896 Std. Dev. estimate 0.89 0.607 0.007 Residual SS -0.004 0.917 0.043 0.806 -0.068 0.046 0.029 0.018 0.083 0.011 Development? Creation? Developing Experience (Months) Knowledge of the Business Programming Language Domain Technology/Framework Domain Knowledge of Tool (Software?) 208.50 23
  • 24.
    RMS ERRORS INCREASEWITH COMPLEXITY 24
  • 25.
    COBOL HAS THEHIGHEST RMS ERROR, LN4 AND JAVA HAVE THE LOWEST 25
  • 26.
    AGENDA 1 Review ofProject Scope 2 Best Practices Research 3 Interview Results 4 Data Analysis and Benchmarking 5 Data Recommendations 6 Go-Forward Plan 26
  • 27.
    THREE KEY DATARECOMMENDATIONS 1 2 3 Baseline the model to the average programmer to establish relative performance Re-define programming language variable to establish proper context Expand upon the current complexity variable to reduce error measurements 27
  • 28.
    1ST RECOMMENDATION: BASELINE THEMODEL TO THE AVERAGE 1 Baseline the model to the average • • • Account for inherent talent Distinguish great performance from poor performance Adjust as necessary to maintain the baseline average 28
  • 29.
    2ND RECOMMENDATION: RE-DEFINE PROGRAMMINGLANGUAGE VARIABLE • 2 Re-define programming language variable • • Current scale for programming language has no predictive relationship Group by language type or on a difficulty scale If neither is used, treat as binary 29
  • 30.
    3RD RECOMMENDATION: EXPAND THECOMPLEXITY VARIABLE • 3 Expand the complexity variable • • Current error measurement grows with project difficulty Change variable to represent more variation in difficulty Add additional break points as needed for accuracy 30
  • 31.
    MOVING BEYOND THEDATA CREATES A HIGH PERFORMANCE CULTURE Aligns Data Soft Skills High Performance Culture 31
  • 32.
    AGENDA 1 Review ofProject Scope 2 Best Practices Research 3 Interview Results 4 Data Analysis and Benchmarking 5 Data Recommendations 6 Go-Forward Plan 32
  • 33.
    OUTLINE OF HOWTO ACHIEVE THESE GOALS Dedicated Estimation Program Office (EPO) Maintenance of existing and development of new resource estimating models and tools by the EPO Next Steps Productivity • Standard productbased CES tailored for different offices in the Department Resource estimating models and tools • Reusable resource catalogs Continual collection of actuals to assist with refinement of estimating models and tools Standard cost estimating quality assessment Estimation Consistency Adopt commercially available tools Consider Agile
  • 34.
    OTHER OPTIONS: STRATEGICAPPLICATION OF AGILE Business Issue Deployment Strategy Project Approach Organizational Culture Determine Business Issue Examine Organizational Culture Assess Deployment Strategy Tailor Project Approach Determine if Agile is a good fit for the needs of the business Examine the beliefs and values articulated by members of the organization Assess the organization to ensure business issue is addressed and organization is minimally disrupted Tailor relevant pieces of the methodology to confirm business issue is fully supported by project team
  • 35.
    OTHER OPTIONS: EFFECTIVEESTIMATION CAPABILITY In addition to organizational commitment, executive sponsor support, and adequate resources, the following is a partial list of critical success factors in building a sustainable resource analysis capability: Success Factor Description Dedicated Program, Team, or Support Expert stewards of the processs and coaches who maintain momnetum and quality across the organization. Product-oriented Cost Element Structure A well understood CES that communicates to the organization what the investment will include. An itemized “invoice” for the investment. Resource Catalogs Predefined reusable increments of scope that have been previously socialized and endorsed/approved. Enables quick, consistent, and defensible definition of a cost/resource estimate. Resource Estimating Models and Tools Standard models and tools which support and enforce the estimating process. Software Sizing Methodology Software costs are a function of the volume of software to be developed. Measuring the volume is critical for all software resource estimation. Quality Assurance / Validation of Investment Proposal QA checklist help ensure thoroughness. Assessments provide maturity measure of process and program capability.
  • 36.
    OTHER OPTIONS: DEVELOPRESOURCE CATALOGS Resource Catalogs include reusable size increments • • • • A resource catalog is a small portion of scope for an IT project A resource catalog will include reusable size increments that will reflect cost, effort, staffing, schedule, labor rates, labor types, and risk Size increments include both non-recurring and recurring costs, and are defined logically or in “T-shirt sizes” Resource catalogs enable: • Quick, consistent, repeatable, and defensible development of lifecycle estimates • Tracking and trend analysis of size increments, enabling better understanding of efficiency gains • Structure for continual estimation process improvement 36
  • 37.
    OTHER OPTIONS: OVERVIEWOF 3RD PARTY SOFTWARE OPTIONS Options for the best software tools to track productivity • According to a 2009 University of California study, developers spend an average of 11 minutes on a task before they are distracted by a separate task • It takes them 25 minutes to get back to the original task Mylyn – open source option Tasktop and Tasktop pro integrate with IBM Rational Cubeon – runs on Google Code 37
  • 38.
    TAKING THESE STEPSWILL RESULT IN SOUND MEASUREMENTS AND ESTIMATIONS 1 Collect More data • Start collecting project actuals • Provide standard data collection templates to enable data analysis • Manage projects against resource estimates Create a resource library • Quick, consistent, repeatable, and defensible development of resource estimates • Tracking and trend analysis of size increments, • Structure for continual estimation process improvement 2 3 Consider alternatives • Third Party Software • Cost oriented product structure • Adoption of Agile development methods
  • 39.
  • 40.
  • 41.
    WE REVIEWED RESEARCHFROM MULTIPLE SOURCES Sample Works Reviewed: Measuring Developers, Aligning Perspectives and other Best Practices by Medha Umarji and Forrest Shull published in the IEEE Software Journal in 2009 The Futility of Developer Productivity Metrics by Neil Mcallister November 17, 2011 http://www.infoworld.com/d/application-development/the-futility-developerproductivity-metrics-179244 Five Requirements for Measuring Application Quality by Jitendra Subramanyam, director of research, CAST Inc. June 17, 2011 http://www.networkworld.com/news/tech/2011/061611-application-quality.html Establishing a Measurement Program, Whitepaper by the Construx Staff 41
  • 42.
    OTHER OPTIONS: STRATEGICAPPLICATION OF AGILE Business Issue Deployment Strategy Project Approach Organizational Culture Determine Business Issue Examine Organizational Culture Assess Deployment Strategy Tailor Project Approach Determine if Agile is a good fit for the needs of the business Examine the beliefs and values articulated by members of the organization Assess the organization to ensure business issue is addressed and organization is minimally disrupted Tailor relevant pieces of the methodology to confirm business issue is fully supported by project team • Project charter • List of key dependencies • Stakeholder interviews • Stakeholder survey & questionnaire results • Deployment strategy plan • Project processes • Project team charter • Project team values Is there high market uncertainty or need for customer involvement? Is the environment rapidly changing? What are the values of the organization? Is the organizational culture conducive to Agile adoption? Who are the key stakeholders? What strategy fits the business need? What strategy is supportable by the organization? What is required to deliver the project? What is the commitment of team members to each other?
  • 43.
    SEVERAL EXPERIMENTS WERERUN WITH THE GMD DATA • Different methods were attempted to achieve a higher R2 for the predictive model • Re-defined variables as categorical •Assigned different weighting to job difficulty • Tested Java programming jobs only • Grouped programming languages by type • Eliminated jobs in which programmers had <6 months experience •High variability • Also experimented with other data mining approaches other than multiple linear regression • Regression trees •Good results (Lower RMS Error), not precise enough for GMD • Principal Components Analysis • Major improvement when base lining to average programmer 43
  • 44.
    OTHER OPTIONS: DEVELOPPRODUCT-ORIENTED COST ELEMENT STRUCTURE • Develop product-oriented cost element structure (CES) that will facilitate decision making • Utilize resource catalogs to populate individual cost elements • Standardize as many of the cost elements as possible to facilitate consistent cost estimation while allowing easy integration of project-specific custom cost elements • Facilitate repeatable and consistent cost reporting with CES standardization • Facilitate consistent and reliable reporting of cost information

Editor's Notes

  • #3 Thank you so much for the opportunity to work with your team over the last few months. We are excited to be here in Lima and share the results of our work.
  • #4 Today we will briefly review the project scope and deliverables that we set a couple of months ago. Then we will present our findings across our best practices research and the interviews we conducted. Next we will dive into the data, providing recommendations for improving your data set and the results of our comparisons to a third party data set. Finally, we want to conclude by offering several suggestions outside of the data modeling for you to consider.
  • #5 As we agreed to in May, the scope of this project was to:Compile a list of software estimation methods, best practices and benchmarks used at competing firms in USAnalyze GMD data and summarize findingsAnalyze third party dataPresent data and suggestions to GMD project sponsors
  • #6 We went about this in the follow way: First, we research industry best practices. We will discuss these in a moment. Then, we went and interviewed subject matter experts across companies of multiple sizes and academia. We will summarize those results today. Next, we analyzed both your data set and a third party data set in an effort to generate recommendations and an equation for your to use moving forward. Finally, we looked beyond the data, taking what we learned in the best practices research and interviews to offer additional suggestions to process improvements to promote efficiencies.
  • #7 We wanted to provide you with a roadmap. A roadmap to improve productivity and estimation consistency. To do this, we feel you need to follow the following steps. First, continually improve the consistency, reliability and productivity of your developers. Next, support consistent and reliable project planning. Then, support timely and effective project estimates. Include bug fixes, re-work and documentation in these estimates. Finally, build and deeply in house estimating and productivity planning capabilities. Throughout our presentation today, we will provide with data and analysis to help your move along this roadmap.
  • #8 Thank you so much for the opportunity to work with your team over the last few months. We are excited to be here in Lima and share the results of our work. Today we will briefly review the project scope and deliverables that we set a couple of months ago. Then we will present our findings across our best practices research and the interviews we conducted. Next we will dive into the data, providing recommendations for improving your data set and the results of our comparisons to a third party data set. Finally, we want to conclude by offering several suggestions outside of the data modeling for you to consider.
  • #9 We reviewed journal articles, white papers, news and blogs to determine several key themes in current development best practices research:First, the best measurements are quantitative and qualitative. Data should be refined and measuredData analysis should be coupled with soft skills analysisThe best developers may not make the best leadersMeasures are best used in large distributed projectsNext, some data is easy to game. For example, counting lines of code is easy to trick. A developer can write one line or three and accomplish the same task. To get around this, make sure that:The metrics are not demoting. They should not be perceived to be putative and should be tracked at a peer, not manager level. Finally, 5 key characteristics should be tracked. First, the data should have the breadth to handle multiple technologies. Then the depth to look at all levels of the application. It should be explicit enough to test against industry standards, actionable to show where improvements can be made and automated as to not detract from the workload.
  • #10 Finally, 5 key characteristics should be tracked. First, the data should have the breadth to handle multiple technologies. Then the depth to look at all levels of the application. It should be explicit enough to test against industry standards, actionable to show where improvements can be made and automated as to not detract from the workload.
  • #11 One of the best recommendations that surfaced from our best practices research was the need to align the goals of your corporation with both your strategic goals as a firm and your technical goals. ON your website, we noted that quality and efficiency, as well as customer satisfaction, were a few of your corporate goals. These can all be easily aligned with several of the themes in our best practices research. Your corporate goal of quality can be translated into a GMD specific goal of product quality and an individual developer goal of software quality. The corporate goal of efficiency means on time delivery for GMD and therefore for the developers on the project. Customer satisfaction remains an overarching goal at all levels. Translating and instilling these goals in your employees at all levels will help the entire organization.
  • #13 To further understand industry best practices being used in the field, we talked to representatives of corporations of all sizes and industry functions—from consulting to small government contractors, to huge multinational corporations
  • #14 One recurring them in the interviews we conducted was that it is difficult to quantify individual developers. Why? Experts gave many reasons:1. Demotivation 2. Non quantifiable skills are better predictors of productivity and quality “ identify the developers …” “ peer code review is key” 3. Doesn’t allow for possibility that great developers influence the solution “a great developer …” “ don’t penalize a developer for taking the time exceed expectations”
  • #15 So let’s briefly take a closer look at the feedback we collected from industry experts …Co-Director, Gtown + theme: challenges to lines of code analysisChief Technologist,SWComplete + theme:soft skills
  • #16 Former Head, AOL Digital Content + theme: teams and codeCIO, Philips IT + theme: teams and soft skillsDirector, Thoughtworks Consulting + theme: multiple developer sources
  • #17 Common theme: apart from IBM most don’t try to track performance of individual developers for varying reasons: + focus on teams + focus on balance of hard and soft skills + focus on testing
  • #28 Travis has gone through our approach to the dataset provided, the 3rd party dataset we acquired, the details of the model based a on a few small changesIn doing so, he has already touched on each of these recommendations but I’m going to take a step back from the details and discuss each of them in a little bit of detail with some examples to emphasize precisely what we believe needs to happen going forward to increase the accuracy and reliability of any predictive modelPlease note that these recommendations apply only to the dataset provided, and not necessarily overall recommendations for GMD in using this practiceAfter I cover each of these data recommendations, Sameer will provide top-level recommendations for GMD going forwardOK, now back to the data set…The first is to re-baseline the regression model being used to the “average” GMD programmer, across the different languagesSecond is to re-define the variable used for the different programming languagesThird is the expand upon the current complexity variable used in the dataset
  • #29 The current model prior to any of our adjustments is built to account for all of the programmers at GMD, or at least everyone that was included in the dataset providedA major variable that will drive a low coefficient will be the wide variation in the talent levels of the programmers on staff at GMDWhile the initial model does include variables for time on the job or experience with the programming language, there is no variable for the inherent talent level of each of the programmersOur approach was to rebaseline the model to the programmers of “average” talent level, provided by Luis, and then apply this model with a higher demonstrated coefficient (or R-squared measure) to the entire workforce to check for errorsThis model will help further illustrate who the high-performing programmers are (who repeatedly beat the time estimate predictions as measured by their errors to the predicted times) and possibly point out which developers need more seasoning or training in order to achieve what is considered to be average performanceFor example: if Travis was consistently producing output at time estimates that were lower than what the model was predicting, it would leave you to believe that he was one of your higher performersManagement can apply these data points to what they already know and believe in terms of talent level of the individual programmers and the “average” programmer in the model can be adjusted accordingly
  • #30 The current model appears to order the programming language variable in the order it was created, older languages have low identifying numbers while more recent languages such as SQL and Crystal have high identifying numbersThe implication in this context has no predictive relationship to the construction time estimates that are currently trying to be modeledSaid another way, there is no direct relationship between “time to construct” and the values applied to each programming language on the current scaleWe recommend simplifying this variable by grouping them by a certain language type such as imperative, declarative, functional or object-oriented and numbering them as such, or ordering the language in terms of “difficulty” so the scale applied actually pertains to the outcome of predicted time to constructIf either of these approaches is not used moving forward, then this variable should be treated as categorical and treated as a binary variable, that is to say the programming language is either Java or it is not, it is either Visual Basic or it is notThis way the predicted time to construct is not artificially inflated or deflated based on the current numbering system that has no predictive contextJust to be clear, without the understanding needed to reorder the programming languages or to provide an accurate grouping, we treated the variable as binary in our adjusted model we have provided and Travis discussed earlier
  • #31 The current model prior to any of our adjustments uses a complexity scale of baja, media, or altaWhile it may be more easier and more efficient to apply this simple approach to the complexity of each job, Travis did touch on the residual errors that grew as the complexity measurement of the job was definedBaja had a low root mean squared error of 1.14, but the alta defined projects had an error four times as high at 4.29There are a few different ways you could approach adjusting this variableThe first would be to assign difficulty ratings that further stratify the complexity of these projectsFor example, baja would be a 1, media would be defined as 3 times difficult – so 3, and alta would be 3 times as difficult as the media – so 9This difference would help show the significant variance in the difficulties and may lead to a more accurate modelA second approach building off of this first one would be to add further difficulty definitions between the three that are already in use, something between baja and media and something else between media and altaIt wouldn’t necessarily be an even split between the projects either, for example one alta project might be twice as difficult as another and would need to be defined as suchFor example, in Kristine’s experience at Bloomberg, different projects are delineated with 1, 2, 3, 5, 8 and 12 as difficulty measurementsThis leads for a more accurate representation of the spread of difficulty across projects and prevents projects from being inaccurately lumped into a category that gets too broad for accurate statistical analysisUnfortunately, in our model we were not able to provide this added level of detail because of our lack of knowledge on the different projects, so it is our hope that the re-baselined model with an correlation of 65% can be improved upon with these complexity adjustmentsAdditionally the error measurements on the media and alta projects can be reduced and brought into line with the rest of the jobs
  • #32 To summarize, the three recommendations we have come up for improving the reliability and accuracy of the model are to:Baseline the model to the average programmerRe-define the programming language variableAnd to expand the complexity variableWith these changes, we are confident that GMD will have a much more useful model to use in predicting construction time for the various software engineersBut at this point, we’d like to re-emphasize some of our findings from research and evaluating known industry standardsThe data will help, but will reach maximum impact when combined with other performance measurements such as soft skills, and is in alignment with overall corporate goalsFrom here, I’ll hand it over to Sameer who will recap our recommendations to this point and will provide some insight into where to go from here, thank you
  • #38 There are many commercially available tools that can help in tracking developer productivity. According to a University of California survey conducted in 2009, in most work environments, developers spend an average of 11 minutes writing code at one time before they are distracted by an unrelated task. They remain on the new task for 25 minutes before returning to the previous task. This is one of the many reasons why tracking software is important, it pulls in data on all tasks performed, not just the primary coding work. There are open source options, options that link to related project management software and options that run on tools from firms such as Google. We have noted the best three options here.
