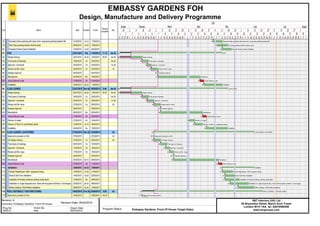

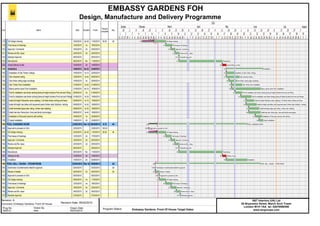

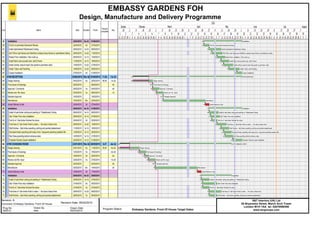

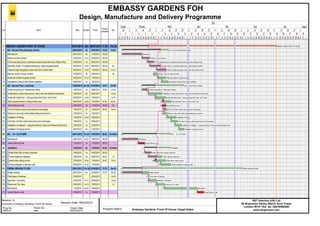

This document is a program status and schedule for the Embassy Gardens front of house project with the following details:
1. It outlines 37 lines of work with start and end dates ranging from January 26, 2015 to July 8, 2015.
2. The work includes joinery, flooring, wall finishes, and other interior elements for areas like the business center, lavatories, stairs, and cinema on the ground floor.
3. Progress percentages are provided for some tasks, with most over 50% complete and a few showing delays of 1-2 weeks.
