Implementing a content strategy:
An eBay use case
Confab – the content strategy conference, Minneapolis
9 – 11 May 2011
                      Nikki Tiedtke . EU Senior Content Strategist

                      Lucie Hyde . Head of Content Mgmt & Strategy - eBay
                      Europe
Contents

1. Our need for a content strategy

2. The context: Business seller communication

3. Key learnings: Implementing a content strategy

4. How we did it: From chaos to content strategy

5. Where are we now? Our content strategy framework

4. Examples of deliverables
                :: Process: workflows and roles diagrams
                :: Quality management: Our framework
                :: Brand opportunity and communication strategy
                :: Messaging hierarchy and information architecture
                :: User research and logfile analysis
                :: Briefing and content templates
                :: EU editorial style guide
Implementing a content strategy: An eBay use case                     2

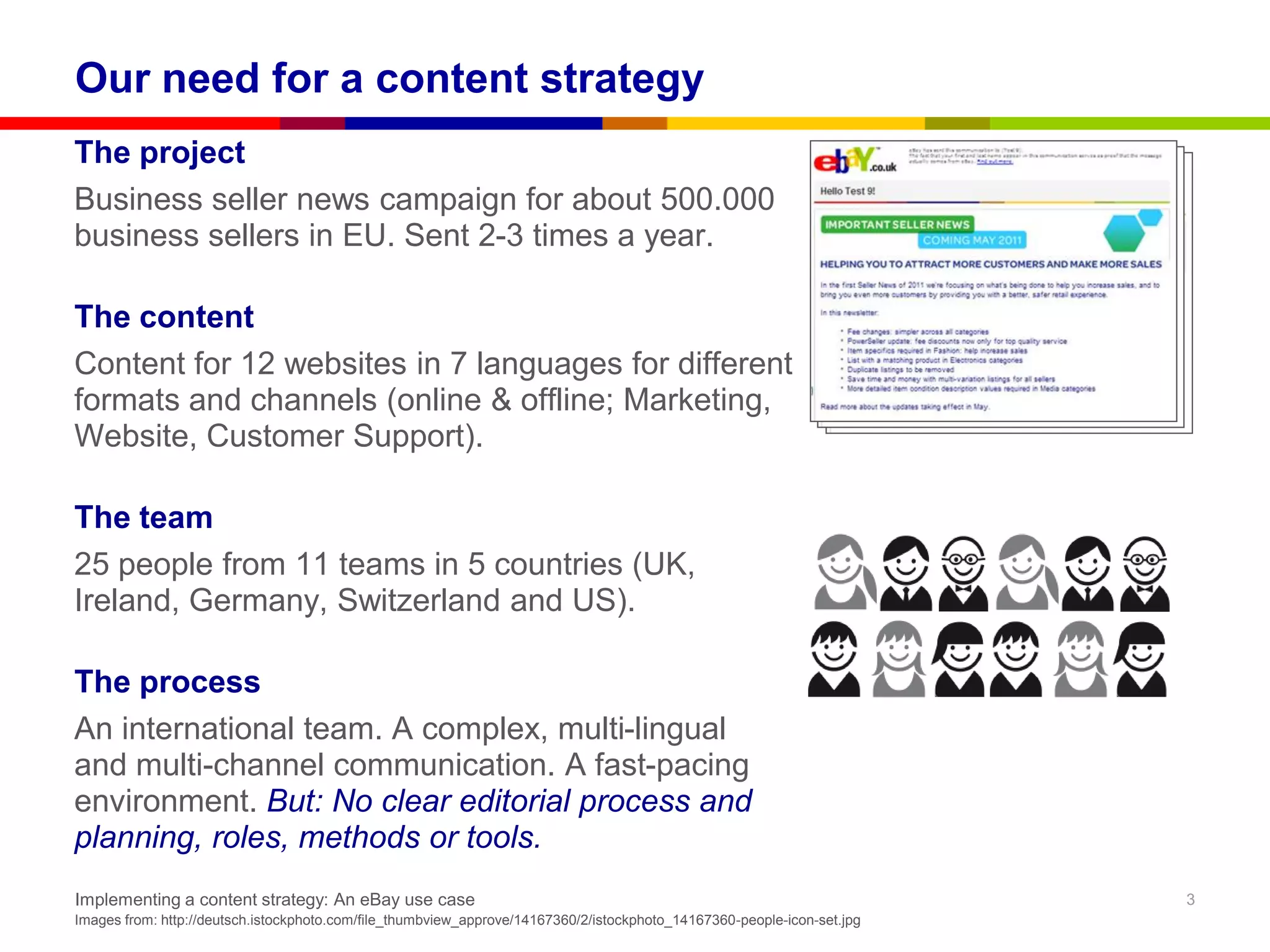

Our need for a content strategy
The project
Business seller news campaign for about 500.000
business sellers in EU. Sent 2-3 times a year.

The content
Content for 12 websites in 7 languages for different
formats and channels (online & offline; Marketing,
Website, Customer Support).

The team
25 people from 11 teams in 5 countries (UK,
Ireland, Germany, Switzerland and US).

The process
An international team. A complex, multi-lingual
and multi-channel communication. A fast-pacing
environment. But: No clear editorial process and
planning, roles, methods or tools.
Implementing a content strategy: An eBay use case                                                                        3
Images from: http://deutsch.istockphoto.com/file_thumbview_approve/14167360/2/istockphoto_14167360-people-icon-set.jpg

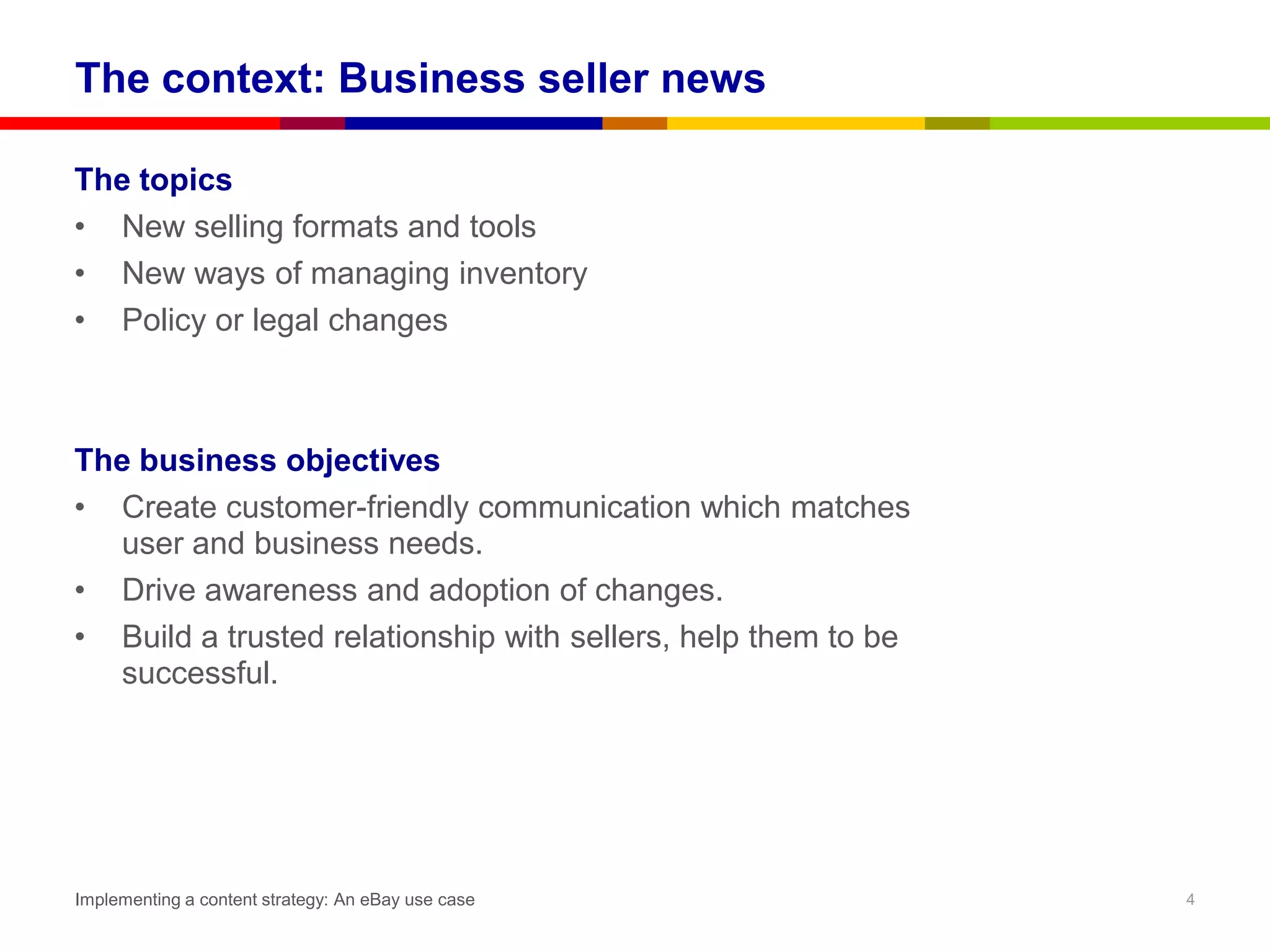

The context: Business seller news

The topics
• New selling formats and tools
• New ways of managing inventory
• Policy or legal changes

The business objectives
• Create customer-friendly communication which matches
  user and business needs.
• Drive awareness and adoption of changes.
• Build a trusted relationship with sellers, help them to be
  successful.

Implementing a content strategy: An eBay use case              4

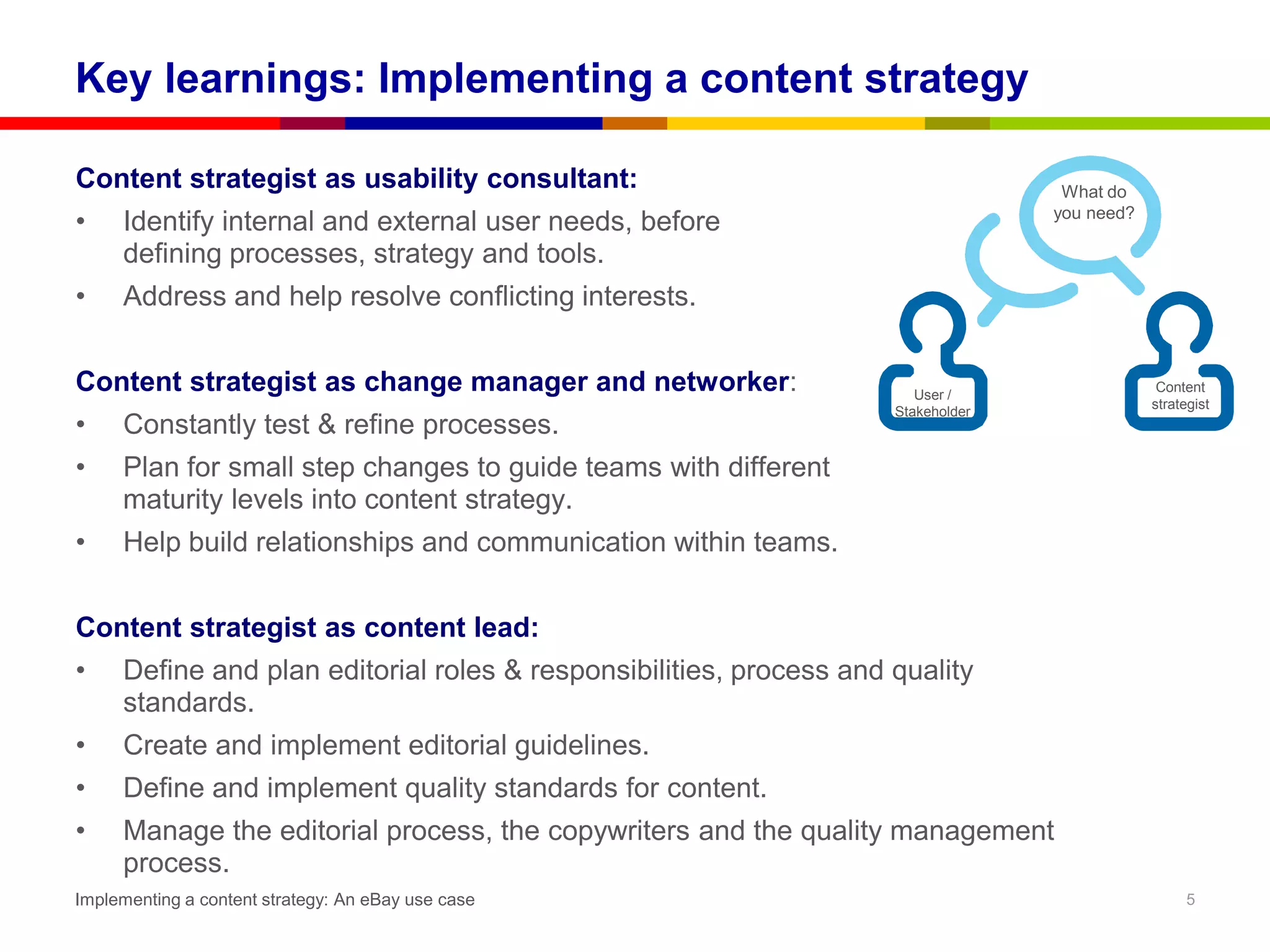

Key learnings: Implementing a content strategy

Content strategist as usability consultant:                                         What do
•    Identify internal and external user needs, before                             you need?

     defining processes, strategy and tools.
•    Address and help resolve conflicting interests.

Content strategist as change manager and networker:                     User /
                                                                                                Content
                                                                                               strategist
                                                                     Stakeholder
•    Constantly test & refine processes.
•    Plan for small step changes to guide teams with different
     maturity levels into content strategy.
•    Help build relationships and communication within teams.

Content strategist as content lead:
•    Define and plan editorial roles & responsibilities, process and quality
     standards.
•    Create and implement editorial guidelines.
•    Define and implement quality standards for content.
•    Manage the editorial process, the copywriters and the quality management
     process.
Implementing a content strategy: An eBay use case                                                    5

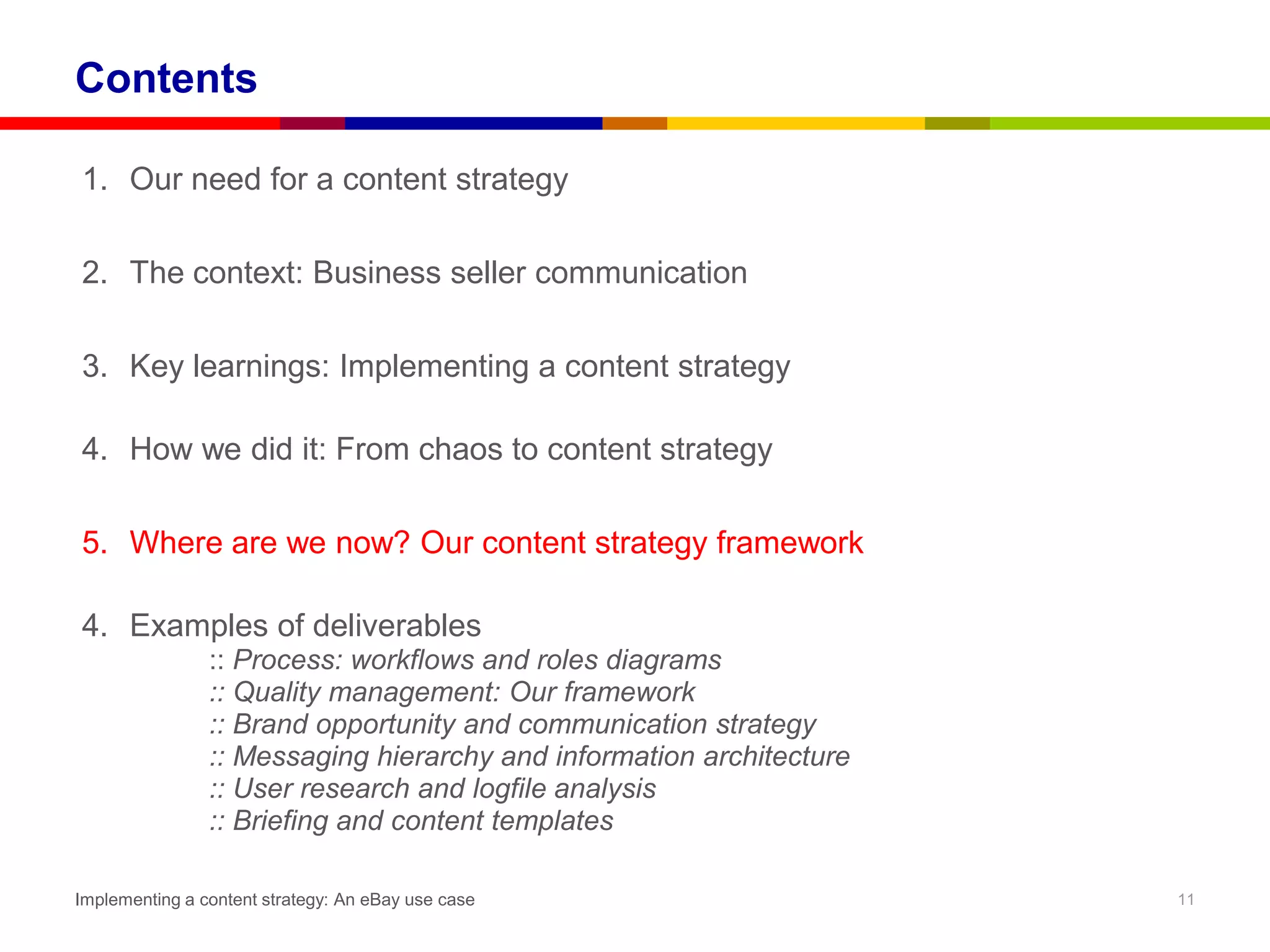

Contents

1. Our need for a content strategy

2. The context: Business seller communication

3. Key learnings: Implementing a content strategy

4. How we did it: From chaos to content strategy

5. Where are we now? Our content strategy framework

4. Examples of deliverables
                :: Process: workflows and roles diagrams
                :: Quality management: Our framework
                :: Brand opportunity and communication strategy
                :: Messaging hierarchy and information architecture
                :: User research and logfile analysis
                :: Briefing and content templates
                :: EU editorial style guide
Implementing a content strategy: An eBay use case                     6

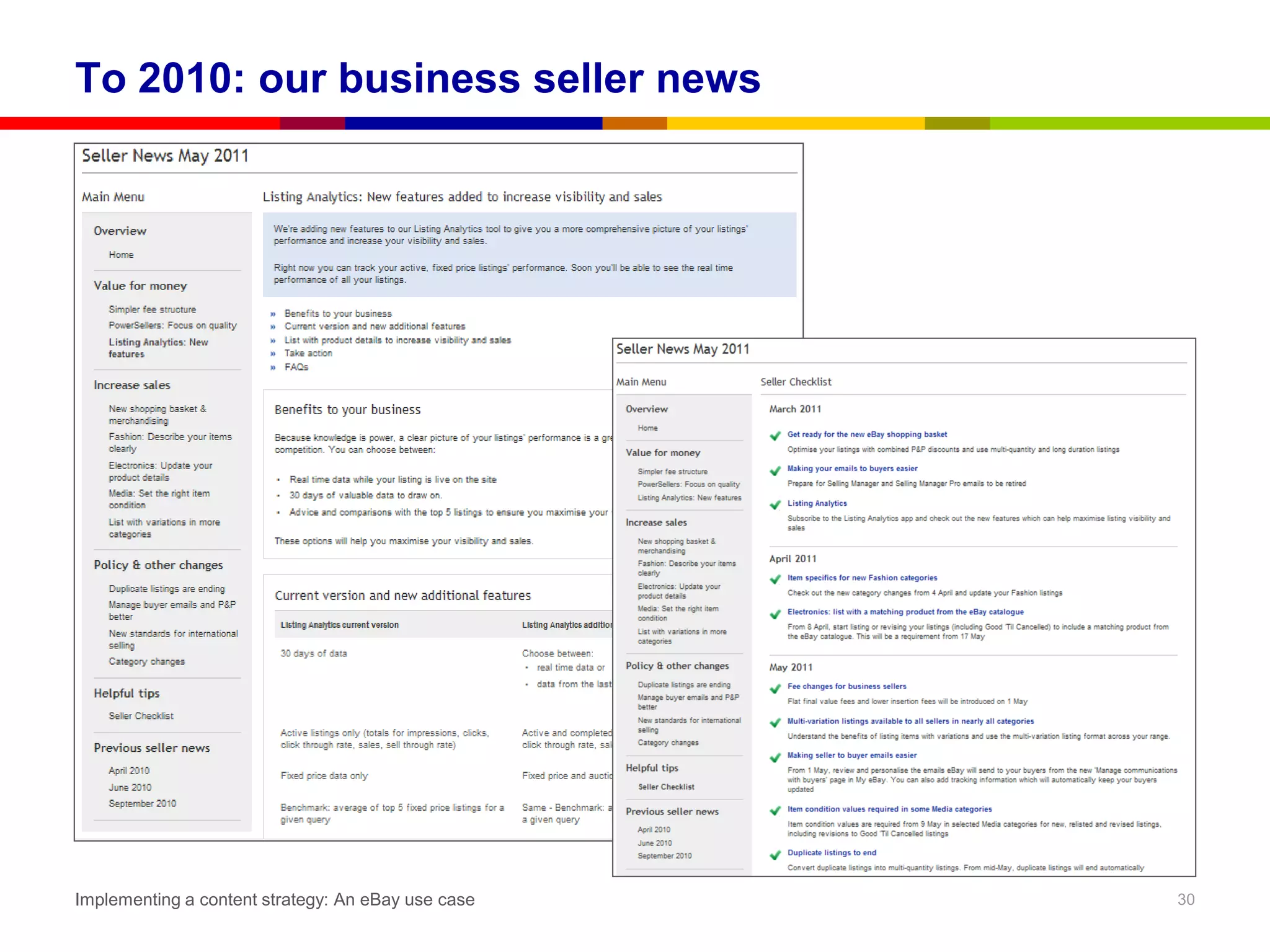

How we did it: From chaos…

      Siloed teams with                                                                 Unclear roles and
      weak relationships                                                                  responsibilities

  No editorial                                                                                        No editorial
  process                                                                                             guidelines

No process                                                                                             No tools and
documentation                                                                                          templates
or training

 No quality                                                                                    No match between
 management                                                                                   business objectives
 standards and criteria                                                                           and user needs

   Implementing a content strategy: An eBay use case                                                                 7
   Image from: http://cache.gawker.com/assets/images/gizmodo/2008/12/rubber-ducks.jpg

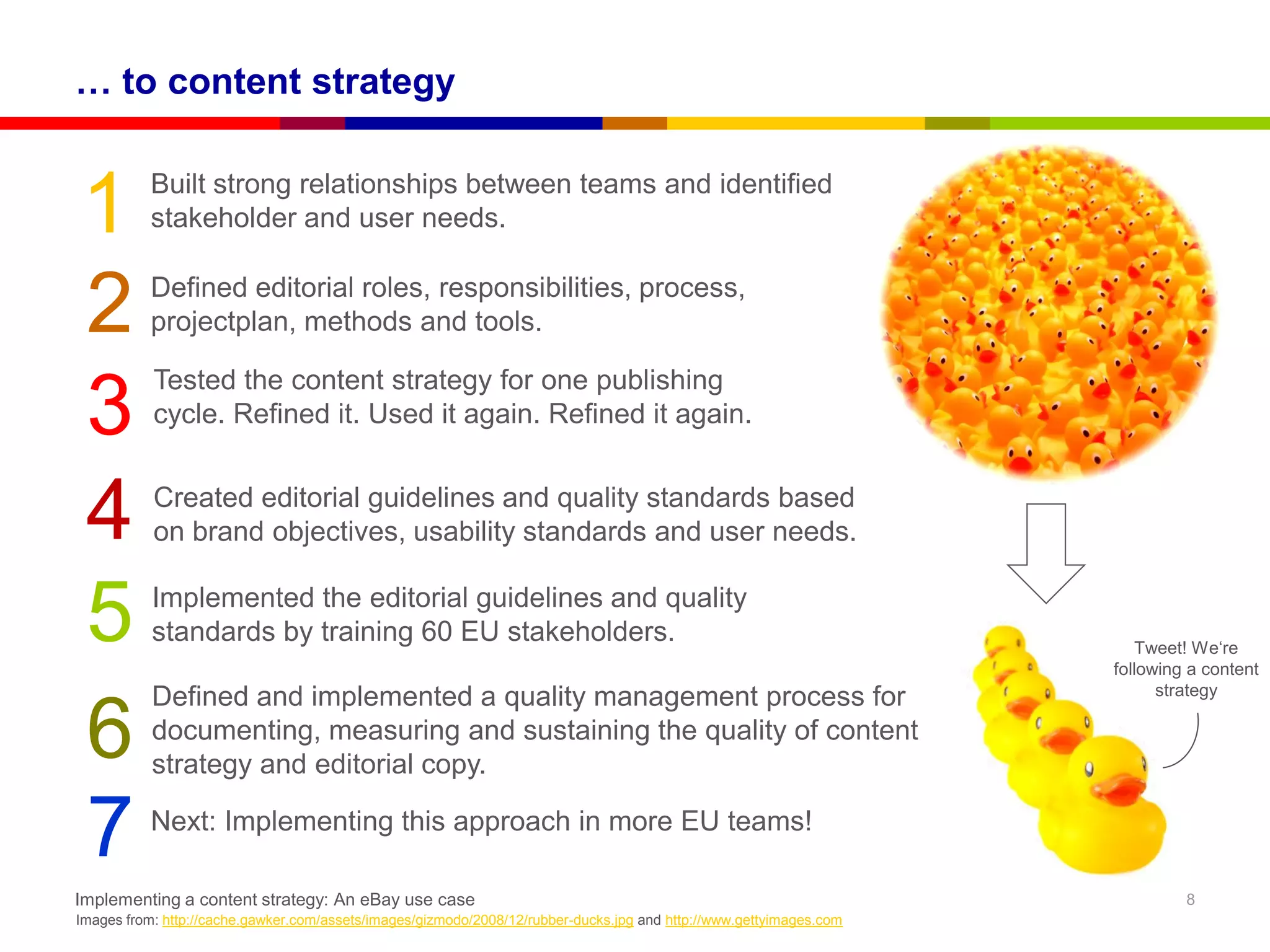

… to content strategy

1          Built strong relationships between teams and identified
           stakeholder and user needs.

2          Defined editorial roles, responsibilities, process,
           projectplan, methods and tools.

           Tested the content strategy for one publishing
3          cycle. Refined it. Used it again. Refined it again.

4          Created editorial guidelines and quality standards based
           on brand objectives, usability standards and user needs.

5          Implemented the editorial guidelines and quality
           standards by training 60 EU stakeholders.                                                                     Tweet! We„re
                                                                                                                     following a content
                                                                                                                           strategy
           Defined and implemented a quality management process for
6          documenting, measuring and sustaining the quality of content
           strategy and editorial copy.

7          Next: Implementing this approach in more EU teams!

Implementing a content strategy: An eBay use case                                                                             8
Images from: http://cache.gawker.com/assets/images/gizmodo/2008/12/rubber-ducks.jpg and http://www.gettyimages.com

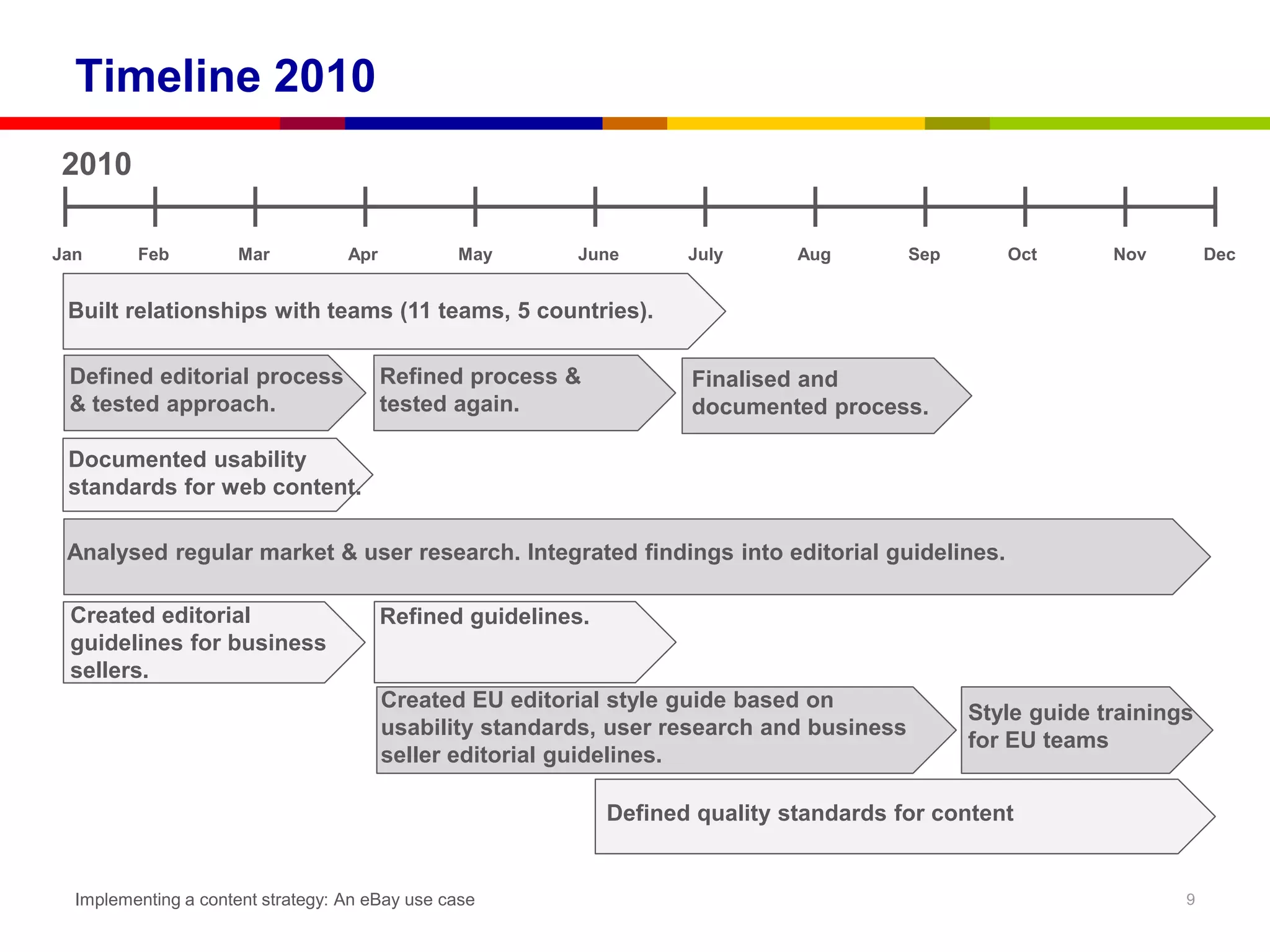

Timeline 2010
2010

Jan      Feb         Mar           Apr          May       June        July      Aug        Sep      Oct       Nov        Dec

 Built relationships with teams (11 teams, 5 countries).

 Defined editorial process               Refined process &            Finalised and
 & tested approach.                      tested again.                documented process.

 Documented usability
 standards for web content.

 Analysed regular market & user research. Integrated findings into editorial guidelines.

 Created editorial                       Refined guidelines.
 guidelines for business
 sellers.
                                         Created EU editorial style guide based on
                                                                                                 Style guide trainings
                                         usability standards, user research and business
                                                                                                 for EU teams
                                         seller editorial guidelines.

                                                               Defined quality standards for content

  Implementing a content strategy: An eBay use case                                                                  9

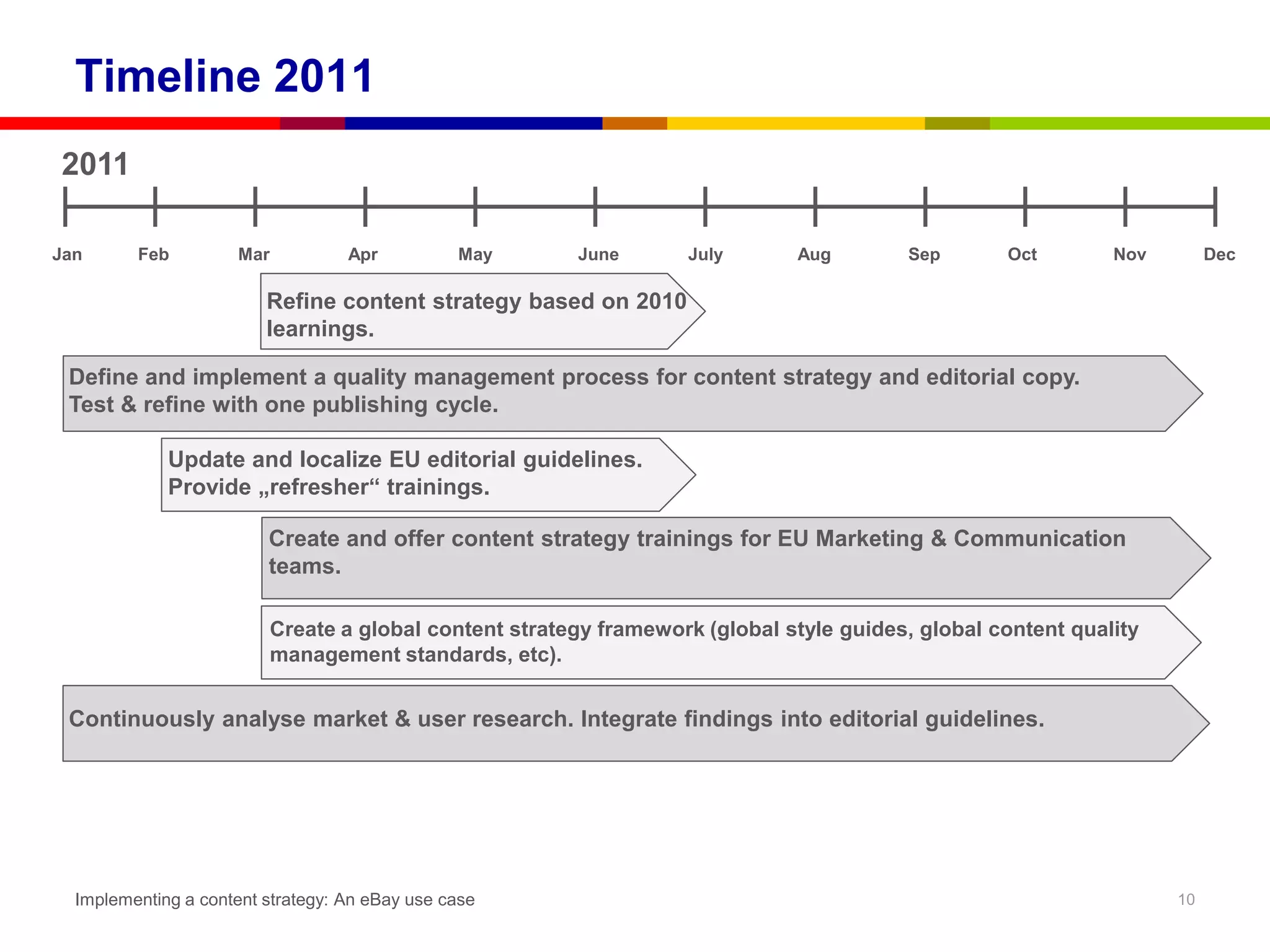

Timeline 2011
2011

Jan      Feb         Mar           Apr          May      June       July       Aug        Sep       Oct        Nov        Dec

                         Refine content strategy based on 2010
                         learnings.

 Define and implement a quality management process for content strategy and editorial copy.
 Test & refine with one publishing cycle.

             Update and localize EU editorial guidelines.
             Provide „refresher“ trainings.

                         Create and offer content strategy trainings for EU Marketing & Communication
                         teams.

                           Create a global content strategy framework (global style guides, global content quality
                           management standards, etc).

 Continuously analyse market & user research. Integrate findings into editorial guidelines.

  Implementing a content strategy: An eBay use case                                                                  10
Contents

1. Our need for a content strategy

2. The context: Business seller communication

3. Key learnings: Implementing a content strategy

4. How we did it: From chaos to content strategy

5. Where are we now? Our content strategy framework

4. Examples of deliverables
                :: Process: workflows and roles diagrams
                :: Quality management: Our framework
                :: Brand opportunity and communication strategy
                :: Messaging hierarchy and information architecture
                :: User research and logfile analysis
                :: Briefing and content templates

Implementing a content strategy: An eBay use case                     11

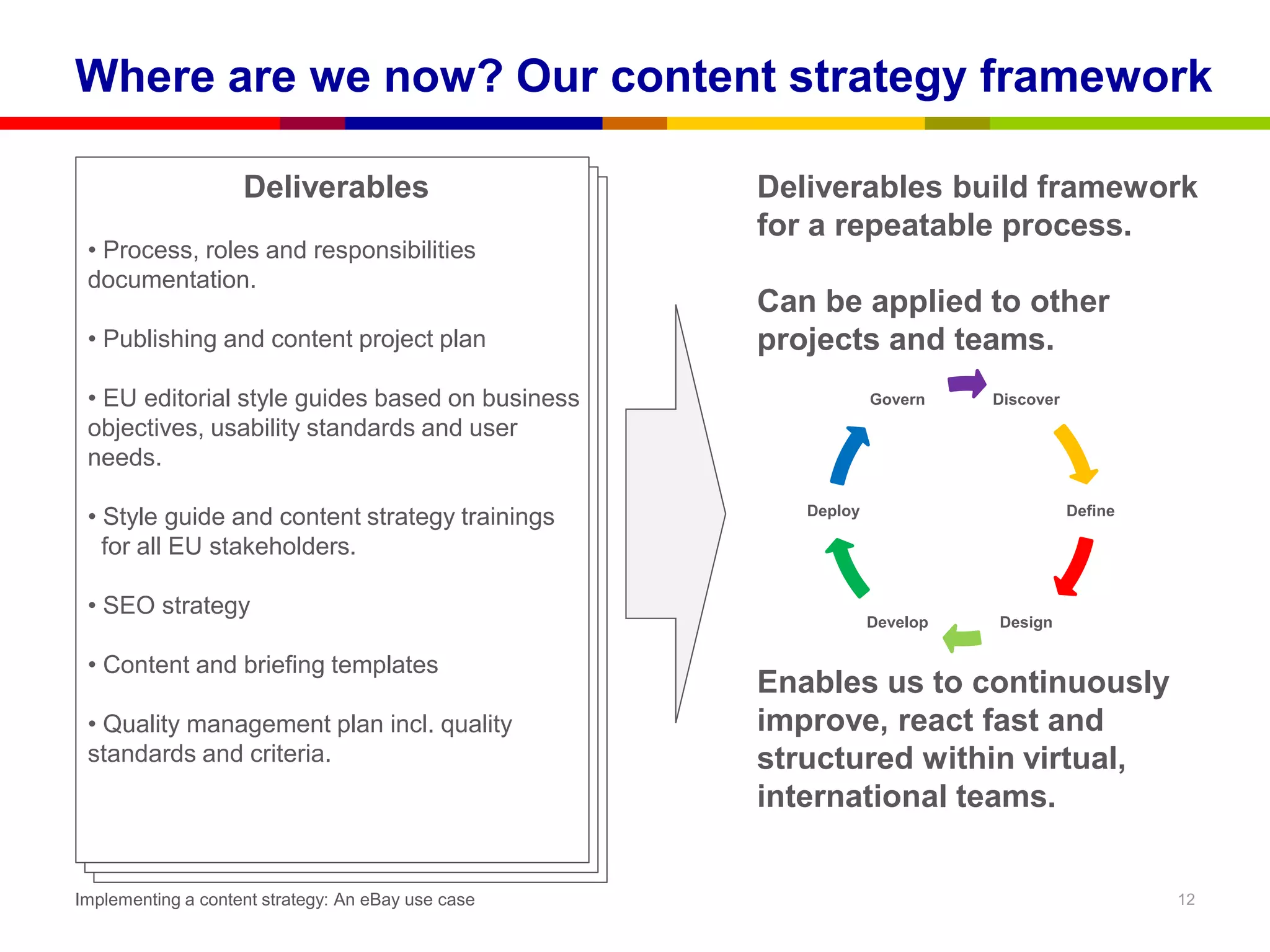

Where are we now? Our content strategy framework

                    Deliverables                    Deliverables build framework
                                                    for a repeatable process.
 • Process, roles and responsibilities
 documentation.
                                                    Can be applied to other
 • Publishing and content project plan              projects and teams.
 • EU editorial style guides based on business                  Govern    Discover
 objectives, usability standards and user
 needs.

 • Style guide and content strategy trainings          Deploy                        Define

   for all EU stakeholders.

 • SEO strategy
                                                                Develop   Design

 • Content and briefing templates
                                                    Enables us to continuously
 • Quality management plan incl. quality            improve, react fast and
 standards and criteria.                            structured within virtual,
                                                    international teams.

Implementing a content strategy: An eBay use case                                             12

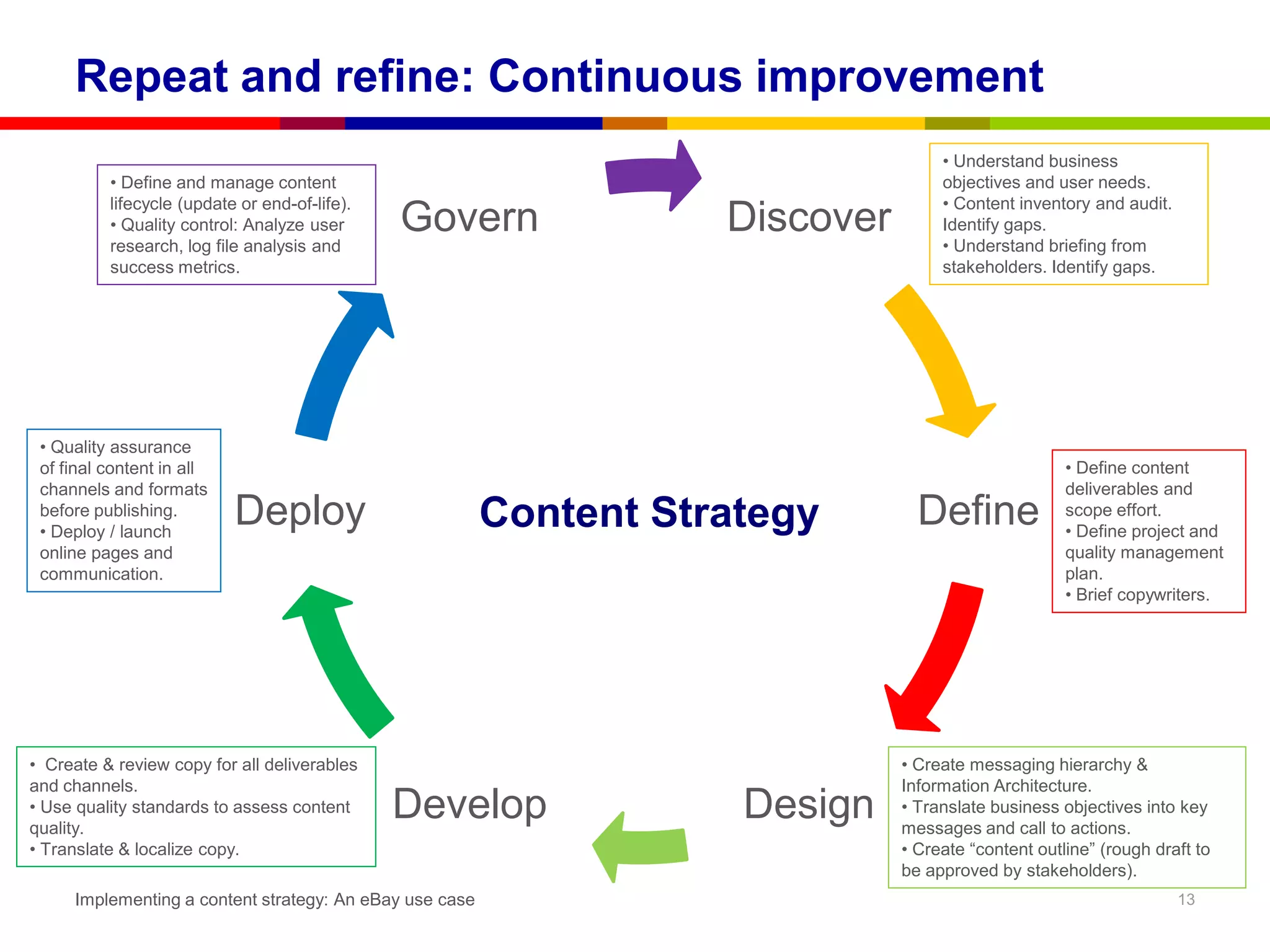

Repeat and refine: Continuous improvement
                                                                                    • Understand business
          • Define and manage content                                               objectives and user needs.
          lifecycle (update or end-of-life).                                        • Content inventory and audit.
          • Quality control: Analyze user
          research, log file analysis and
                                               Govern               Discover        Identify gaps.
                                                                                    • Understand briefing from
          success metrics.                                                          stakeholders. Identify gaps.

 • Quality assurance
 of final content in all                                                                             • Define content
 channels and formats                                                                                deliverables and
 before publishing.
 • Deploy / launch
                           Deploy                        Content Strategy        Define              scope effort.
                                                                                                     • Define project and
 online pages and                                                                                    quality management
 communication.                                                                                      plan.
                                                                                                     • Brief copywriters.

• Create & review copy for all deliverables                                    • Create messaging hierarchy &
and channels.                                                                  Information Architecture.
• Use quality standards to assess content
quality.
                                               Develop               Design    • Translate business objectives into key
                                                                               messages and call to actions.
• Translate & localize copy.                                                   • Create “content outline” (rough draft to
                                                                               be approved by stakeholders).
     Implementing a content strategy: An eBay use case                                                               13
Contents

1. Our need for a content strategy

2. The context: Business seller communication

3. Key learnings: Implementing a content strategy

4. How we did it: From chaos to content strategy

5. Where are we now? Our content strategy framework

4. Examples of deliverables
                :: Process: workflows and roles diagrams
                :: Quality management: Our framework
                :: Brand opportunity and communication strategy
                :: Messaging hierarchy and information architecture
                :: User research and logfile analysis
                :: Briefing and content templates

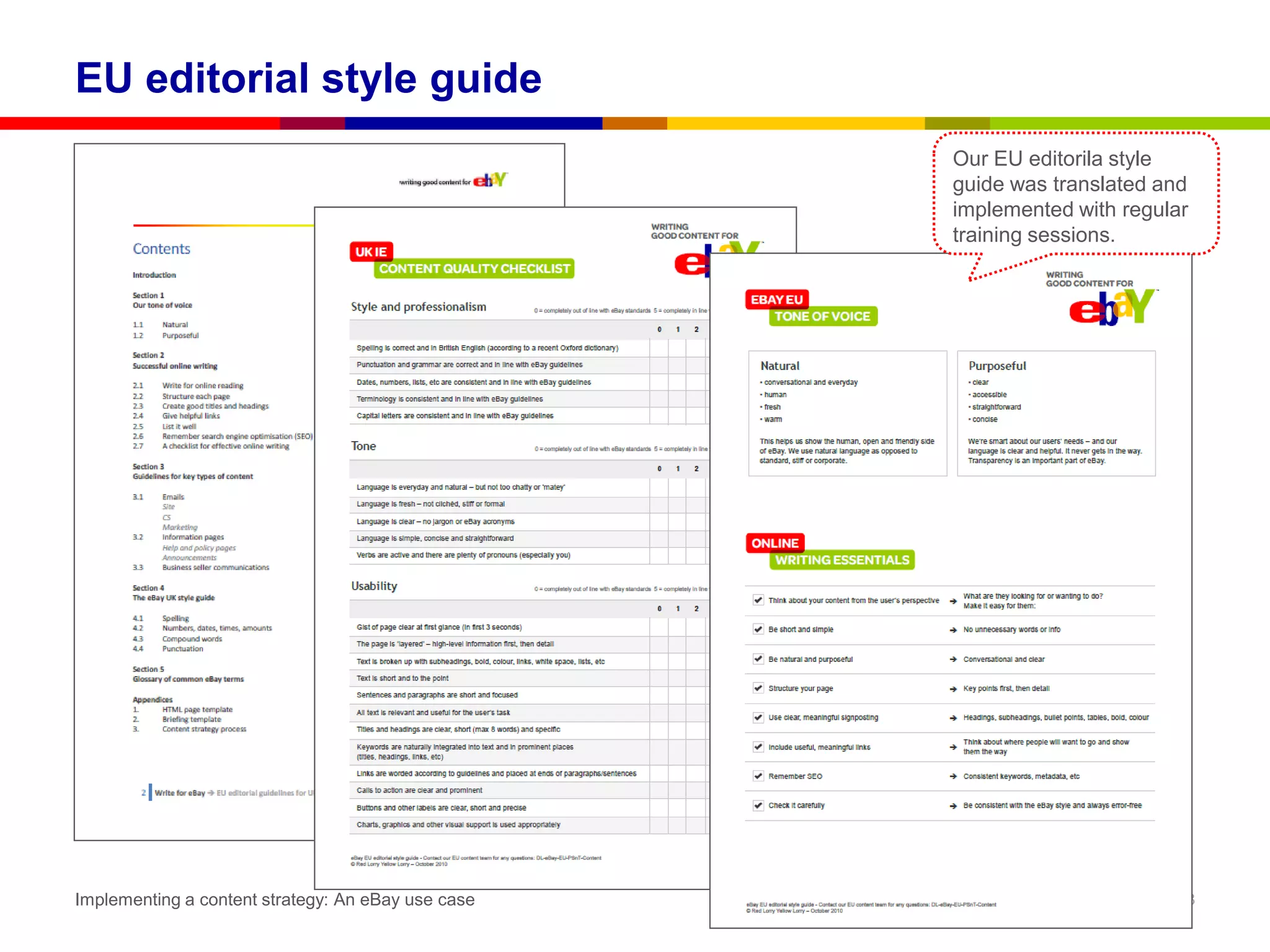

                :: EU editorial style guide
Implementing a content strategy: An eBay use case                     14

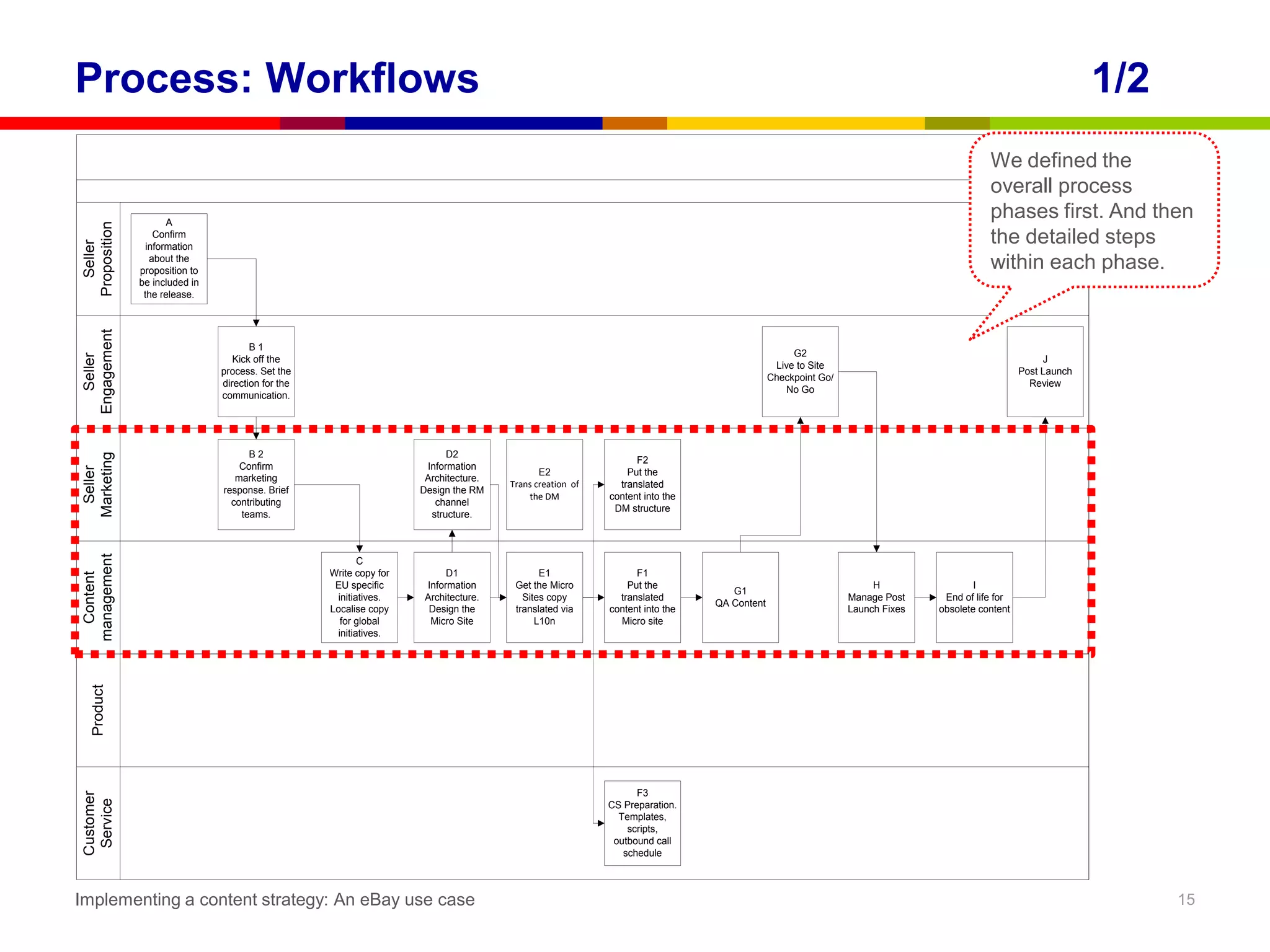

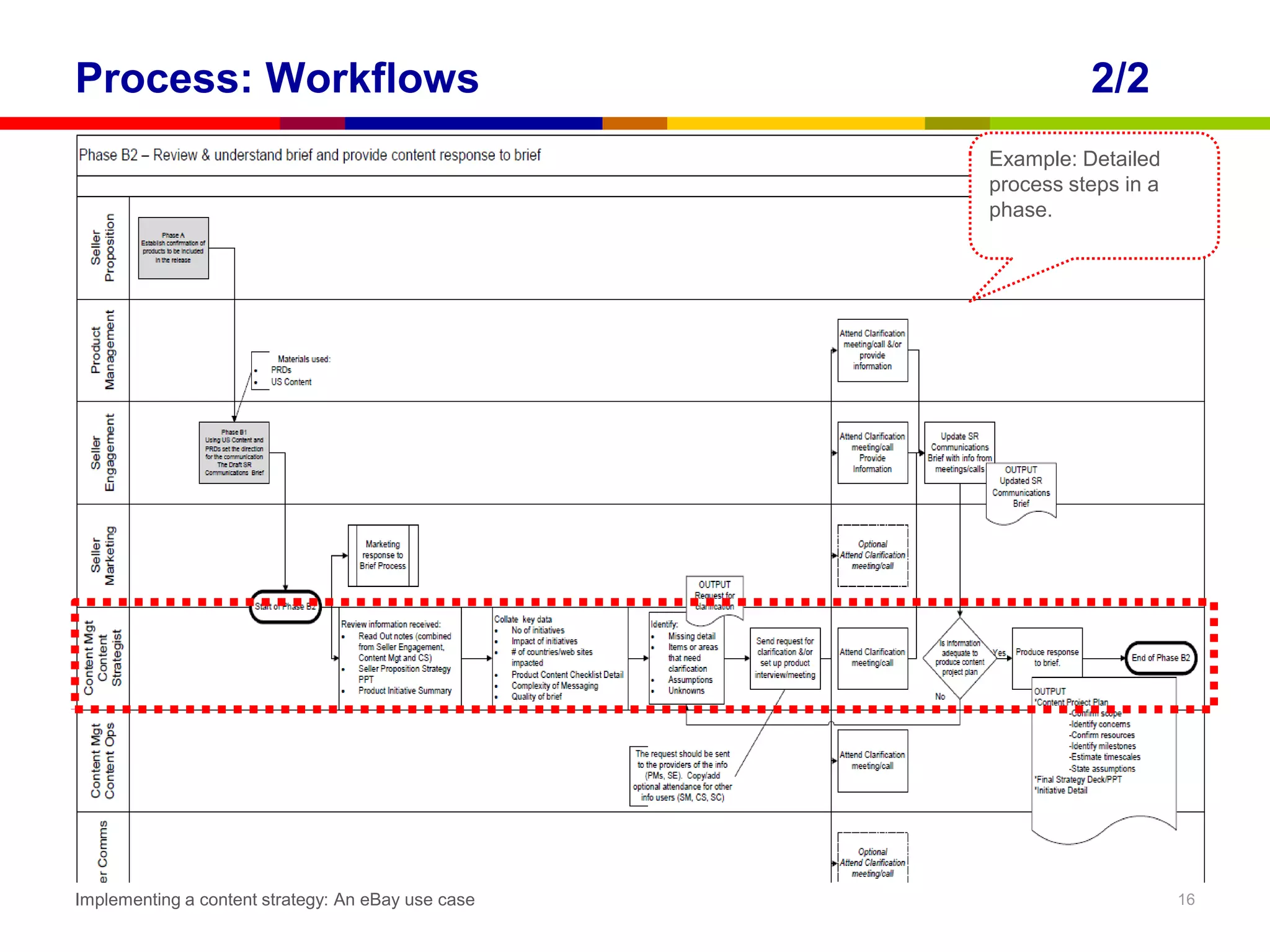

Process: Workflows                                                                                                                                                                                         1/2
Highest Level Major Seller Release Responsibility Map TO BE (Proposed)                                                                                                               We defined the
                                                                                                                                                                                     overall process
                      A
                                                                                                                                                                                     phases first. And then
 Proposition

                   Confirm
                                                                                                                                                                                     the detailed steps
   Seller

                 information
                  about the
               proposition to                                                                                                                                                        within each phase.
               be included in
                the release.
 Engagement

                                       B1
                                                                                                                                               G2
    Seller

                                   Kick off the                                                                                                                                                   J
                                                                                                                                           Live to Site
                                process. Set the                                                                                                                                             Post Launch
                                                                                                                                          Checkpoint Go/
                                direction for the                                                                                                                                              Review
                                                                                                                                              No Go
                                communication.

                                      B2                                   D2
 Marketing

                                                                                                                F2
                                    Confirm                           Information
  Seller

                                                                                             E2               Put the
                                   marketing                          Architecture.
                                                                                      Trans creation of     translated
                                response. Brief                      Design the RM
                                                                                          the DM          content into the
                                  contributing                          channel
                                                                                                           DM structure
                                    teams.                             structure.
 management

                                                           C
                                                    Write copy for         D1                E1                 F1
   Content

                                                     EU specific      Information      Get the Micro          Put the                                           H                 I
                                                                                                                                G1
                                                     initiatives.     Architecture.      Sites copy         translated                                     Manage Post     End of life for
                                                                                                                             QA Content
                                                    Localise copy      Design the      translated via     content into the                                 Launch Fixes   obsolete content
                                                      for global       Micro Site           L10n            Micro site
                                                     initiatives.
    Product

                                                                                                                F3
 Customer
  Service

                                                                                                          CS Preparation.
                                                                                                            Templates,
                                                                                                              scripts,
                                                                                                           outbound call
                                                                                                             schedule

Implementing a content strategy: An eBay use case                                                                                                                                                                15
Process: Workflows                                            2/2
                                                    Example: Detailed
                                                    process steps in a
                                                    phase.

Implementing a content strategy: An eBay use case                        16
In addition to the process
                                                    documentation we defined the

Process: Roles and responsibilities                 detailed roles and responsibilities for
                                                    each process step.

Implementing a content strategy: An eBay use case                                   17

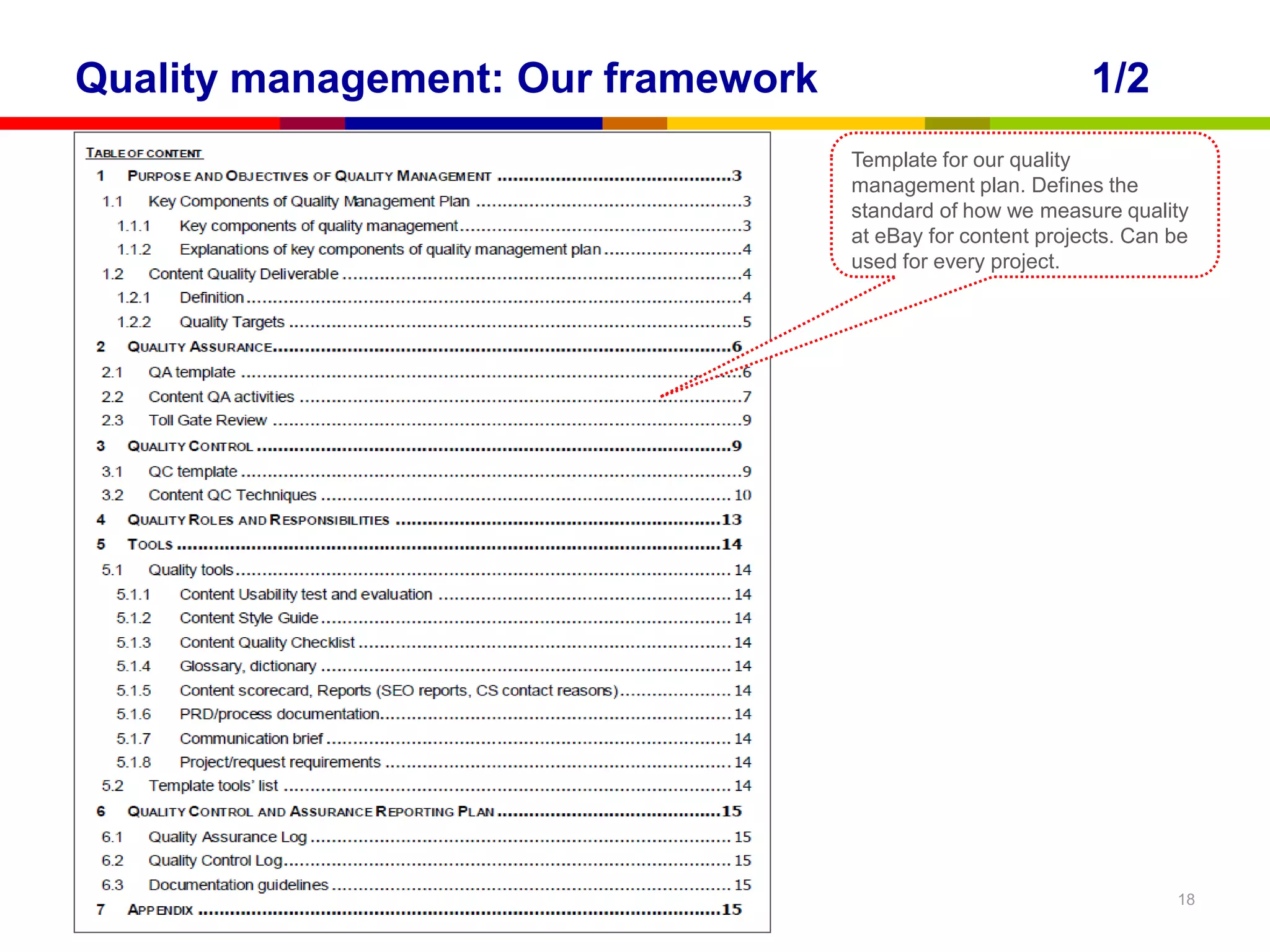

Quality management: Our framework                                            1/2
                                                    Template for our quality
                                                    management plan. Defines the
                                                    standard of how we measure quality
                                                    at eBay for content projects. Can be
                                                    used for every project.

Implementing a content strategy: An eBay use case                                     18

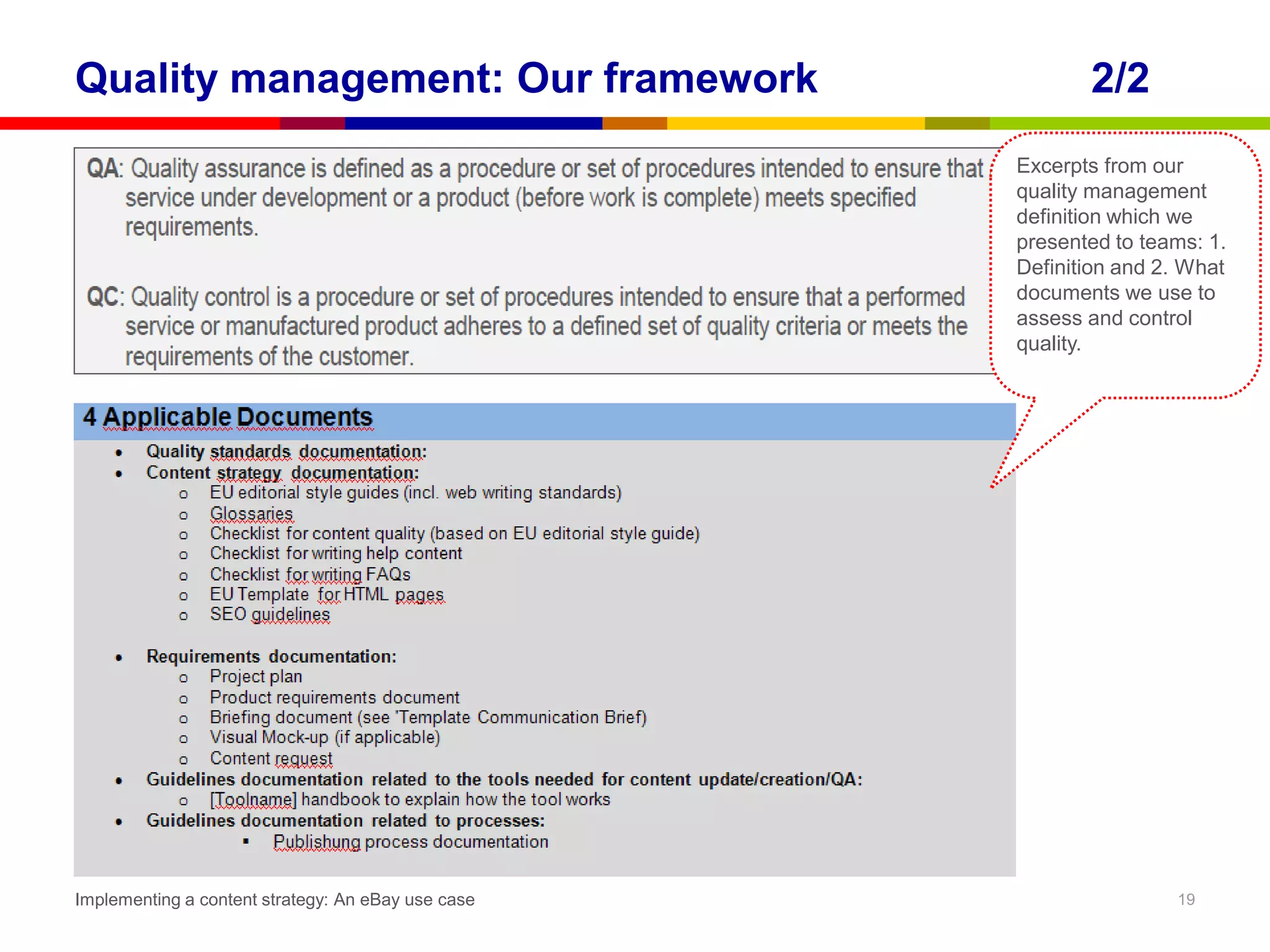

Quality management: Our framework                          2/2
                                                    Excerpts from our
                                                    quality management
                                                    definition which we
                                                    presented to teams: 1.
                                                    Definition and 2. What
                                                    documents we use to
                                                    assess and control
                                                    quality.

Implementing a content strategy: An eBay use case                   19

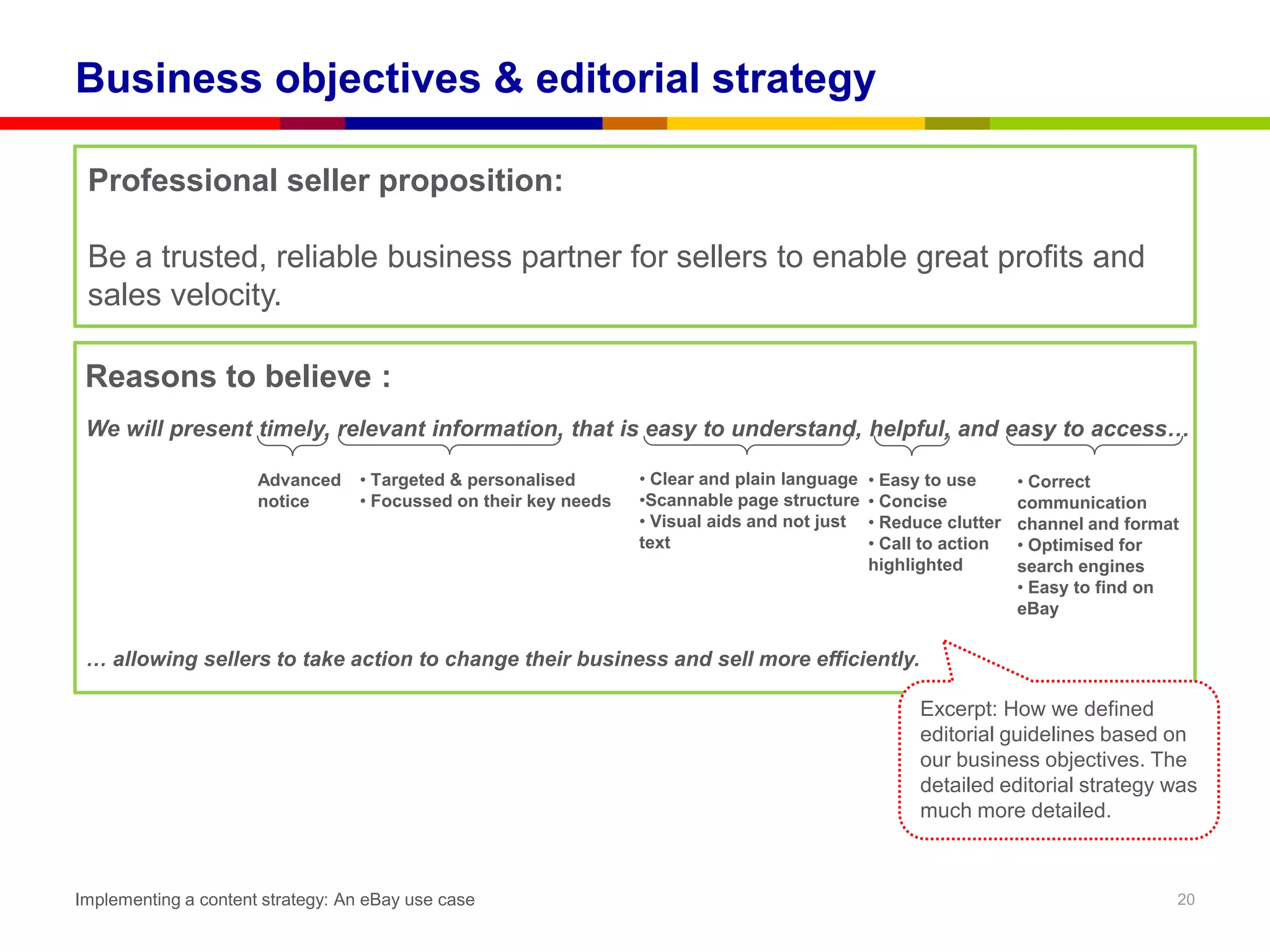

Business objectives & editorial strategy

 Professional seller proposition:

 Be a trusted, reliable business partner for sellers to enable great profits and
 sales velocity.

 Reasons to believe :
 We will present timely, relevant information, that is easy to understand, helpful, and easy to access…

                      Advanced    • Targeted & personalised       • Clear and plain language   • Easy to use      • Correct
                      notice      • Focussed on their key needs   •Scannable page structure    • Concise          communication
                                                                  • Visual aids and not just   • Reduce clutter   channel and format
                                                                  text                         • Call to action   • Optimised for
                                                                                               highlighted        search engines
                                                                                                                  • Easy to find on
                                                                                                                  eBay

 … allowing sellers to take action to change their business and sell more efficiently.

                                                                                                     Excerpt: How we defined
                                                                                                     editorial guidelines based on
                                                                                                     our business objectives. The
                                                                                                     detailed editorial strategy was
                                                                                                     much more detailed.

Implementing a content strategy: An eBay use case                                                                                  20

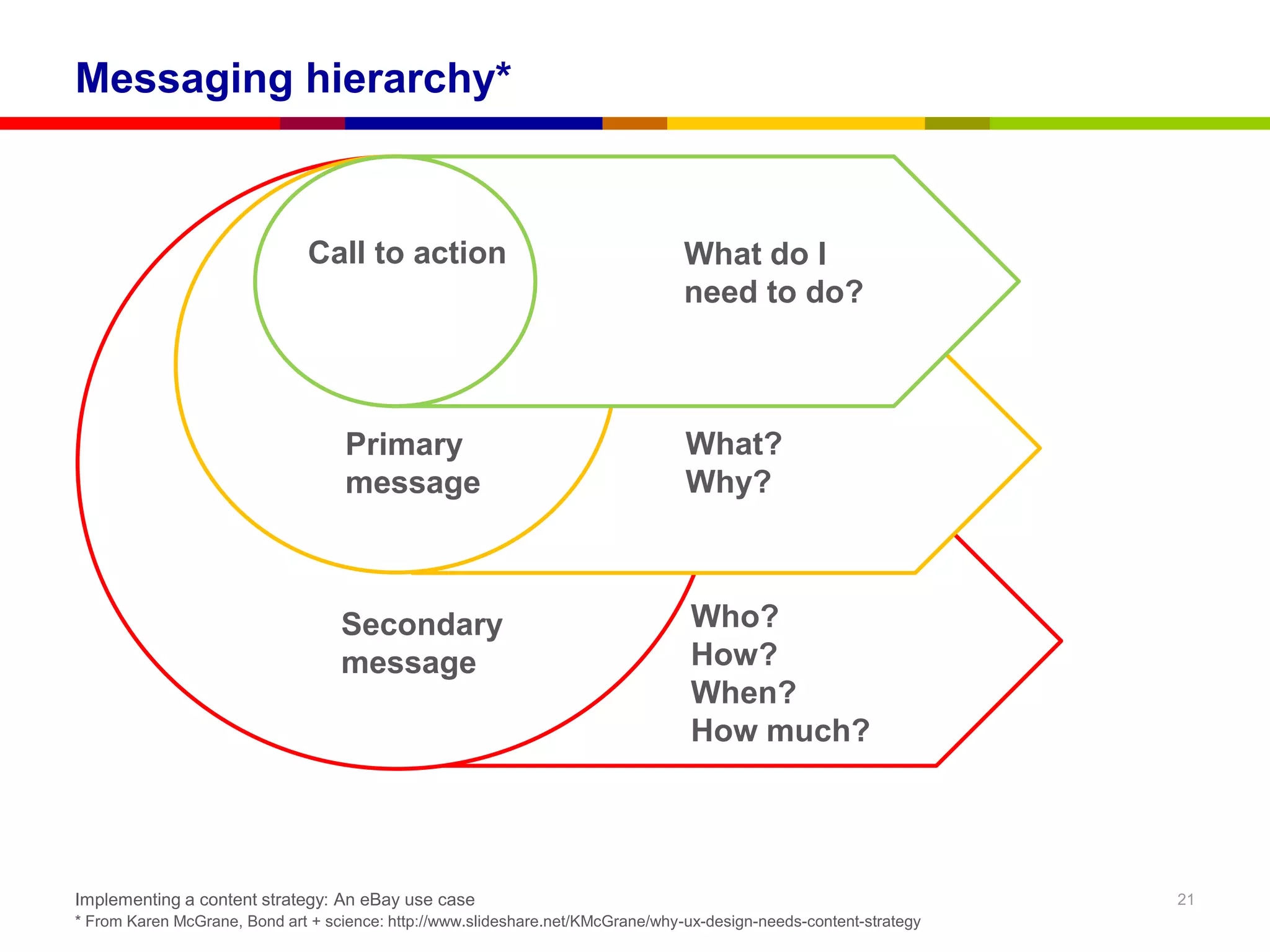

Messaging hierarchy*

                               Call to action                                    What do I
                                                                                 need to do?

                                    Primary                                      What?
                                    message                                      Why?

                                   Secondary                                      Who?
                                   message                                        How?
                                                                                  When?
                                                                                  How much?

Implementing a content strategy: An eBay use case                                                                   21
* From Karen McGrane, Bond art + science: http://www.slideshare.net/KMcGrane/why-ux-design-needs-content-strategy

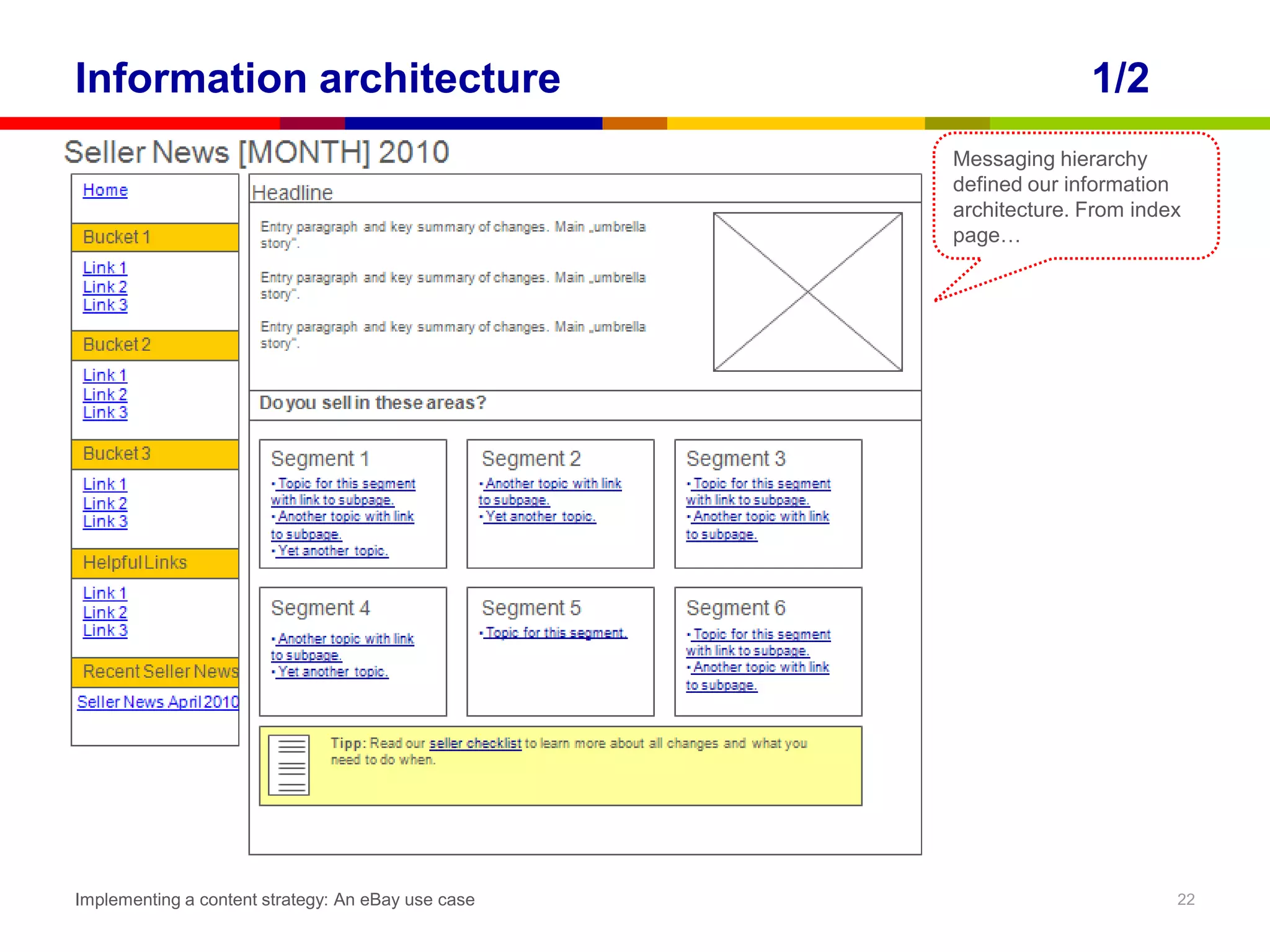

Information architecture                                          1/2
                                                    Messaging hierarchy
                                                    defined our information
                                                    architecture. From index
                                                    page…

Implementing a content strategy: An eBay use case                          22
Information architecture                                         2/2
                                                    … to single subpage.

Implementing a content strategy: An eBay use case                          23

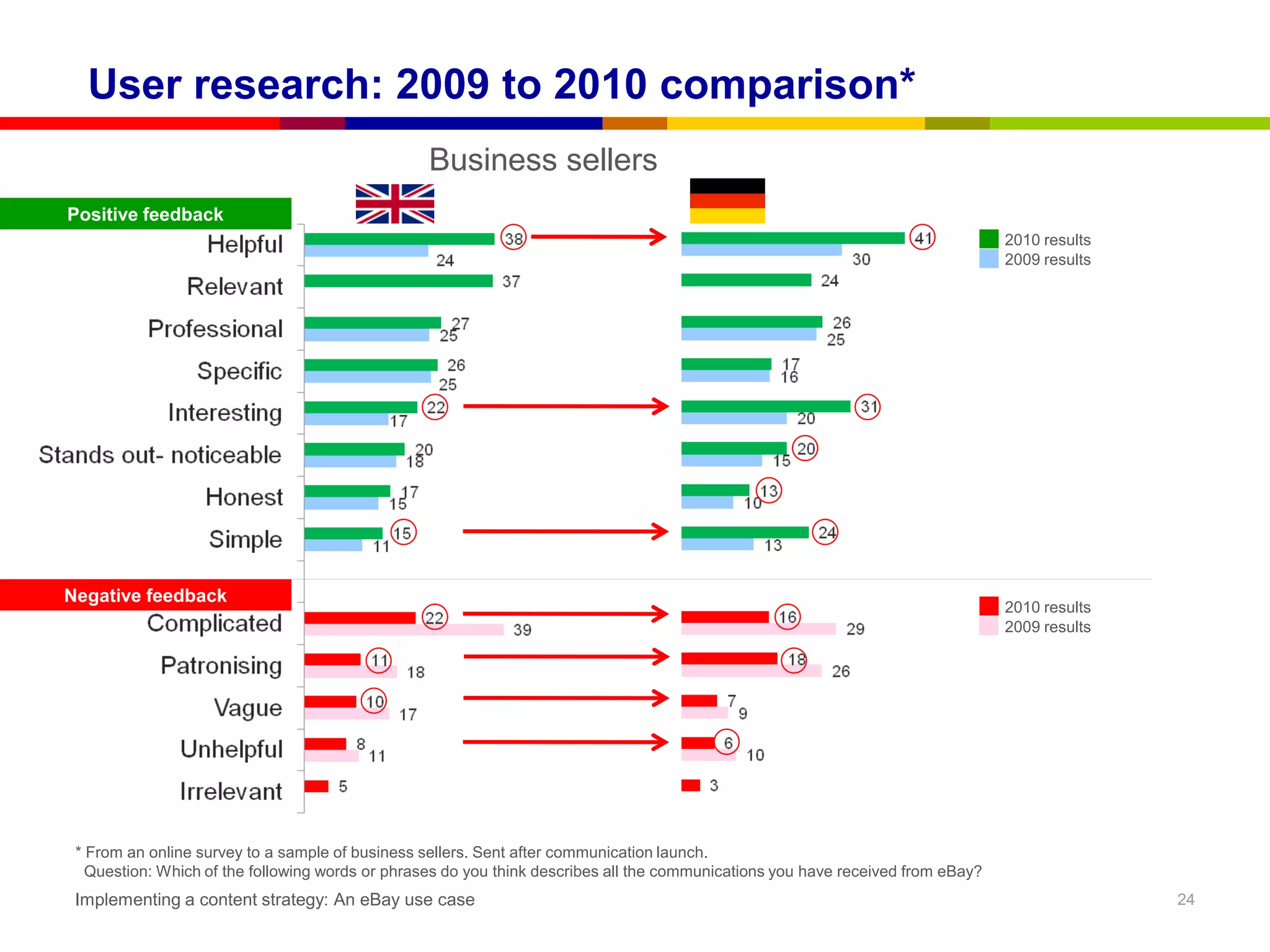

User research: 2009 to 2010 comparison*
                                                  Business sellers
Positive feedback
                                                                                                                                  2010 results
                                                                                                                                  2009 results

Negative feedback
                                                                                                                                  2010 results
                                                                                                                                  2009 results

 * From an online survey to a sample of business sellers. Sent after communication launch.
   Question: Which of the following words or phrases do you think describes all the communications you have received from eBay?
 Implementing a content strategy: An eBay use case                                                                                               24

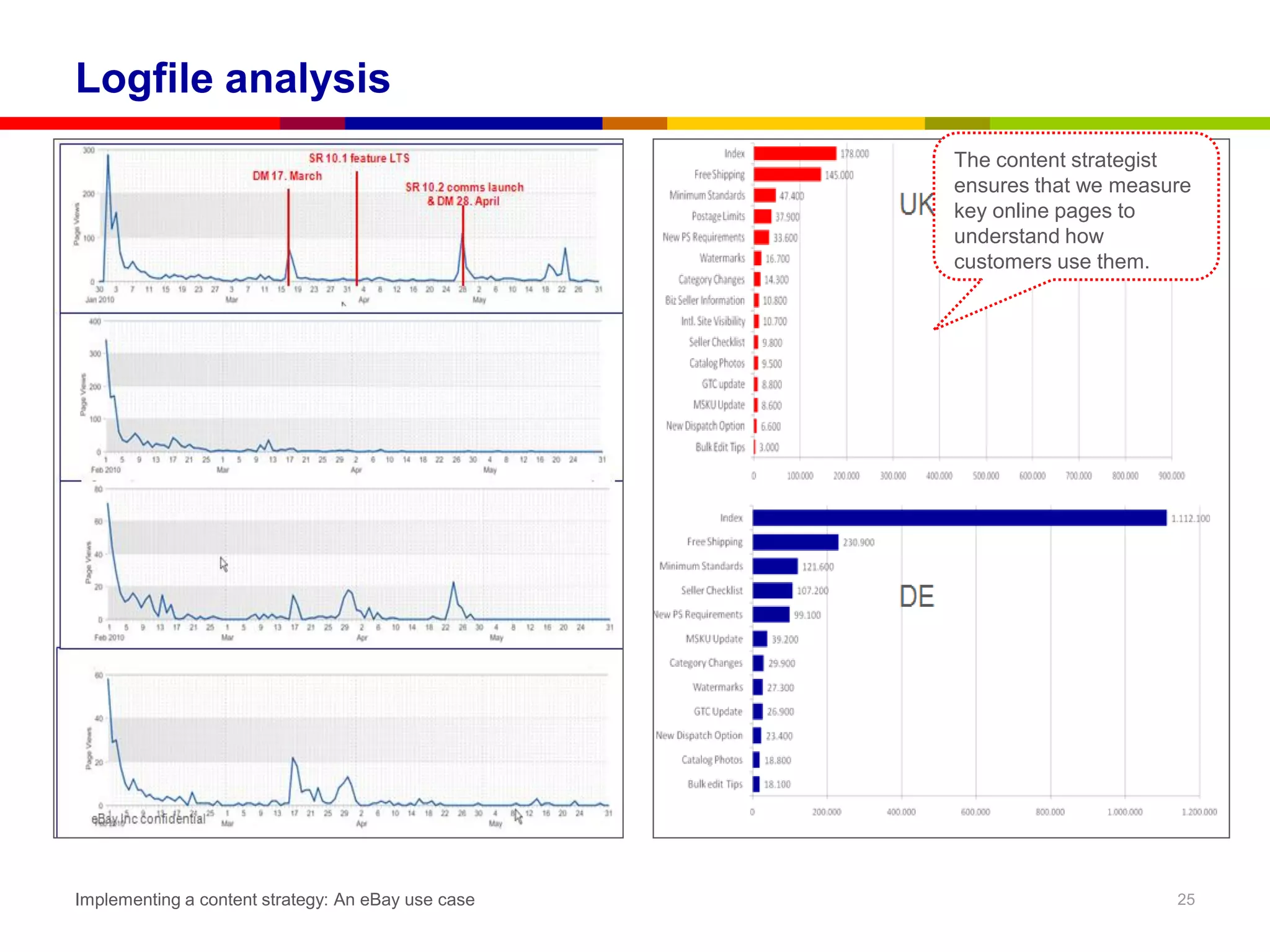

Logfile analysis
                                                    The content strategist
                                                    ensures that we measure
                                                    key online pages to
                                                    understand how
                                                    customers use them.

Implementing a content strategy: An eBay use case                        25

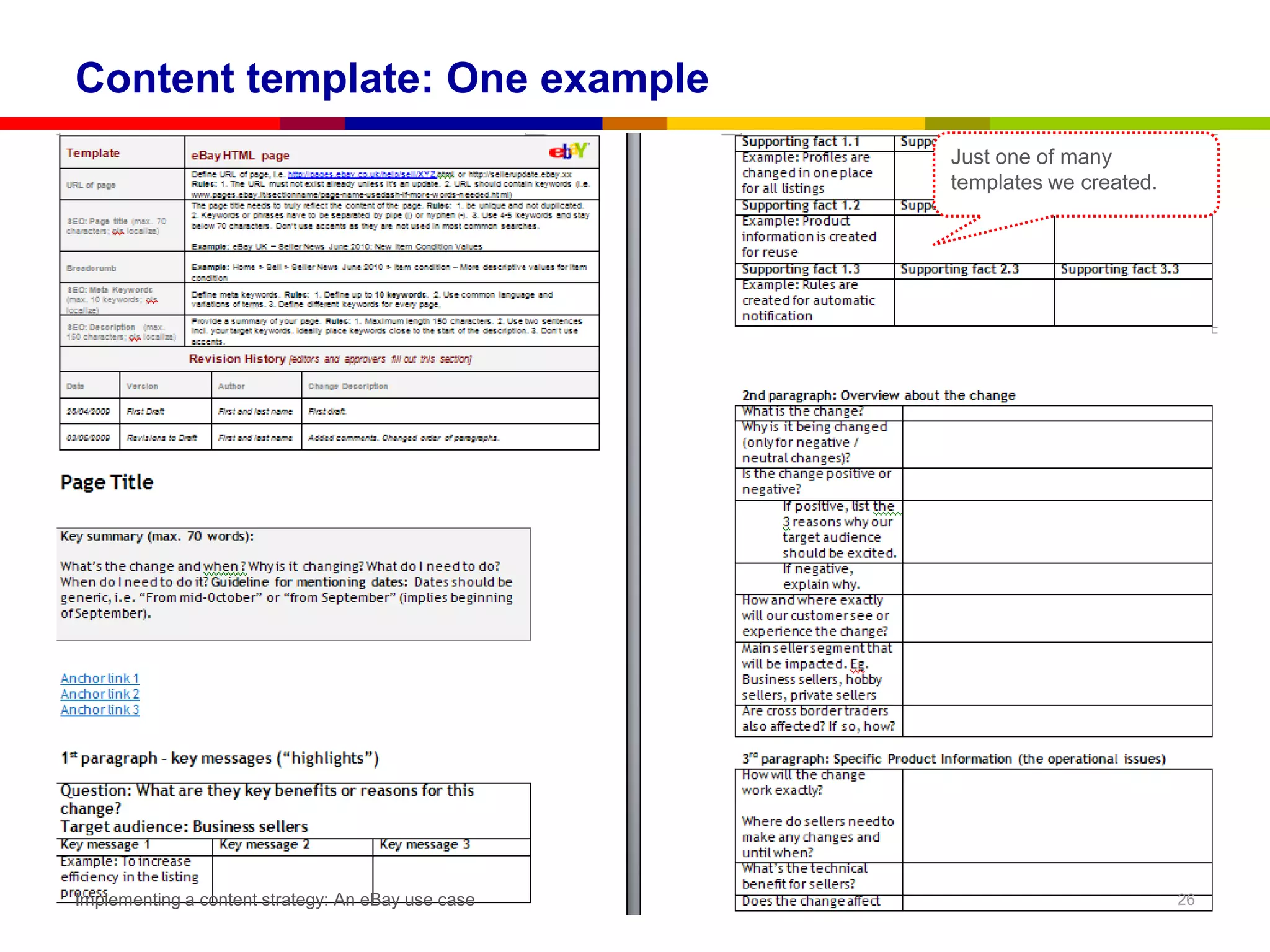

Content template: One example
                                                    Just one of many
                                                    templates we created.

Implementing a content strategy: An eBay use case                           26

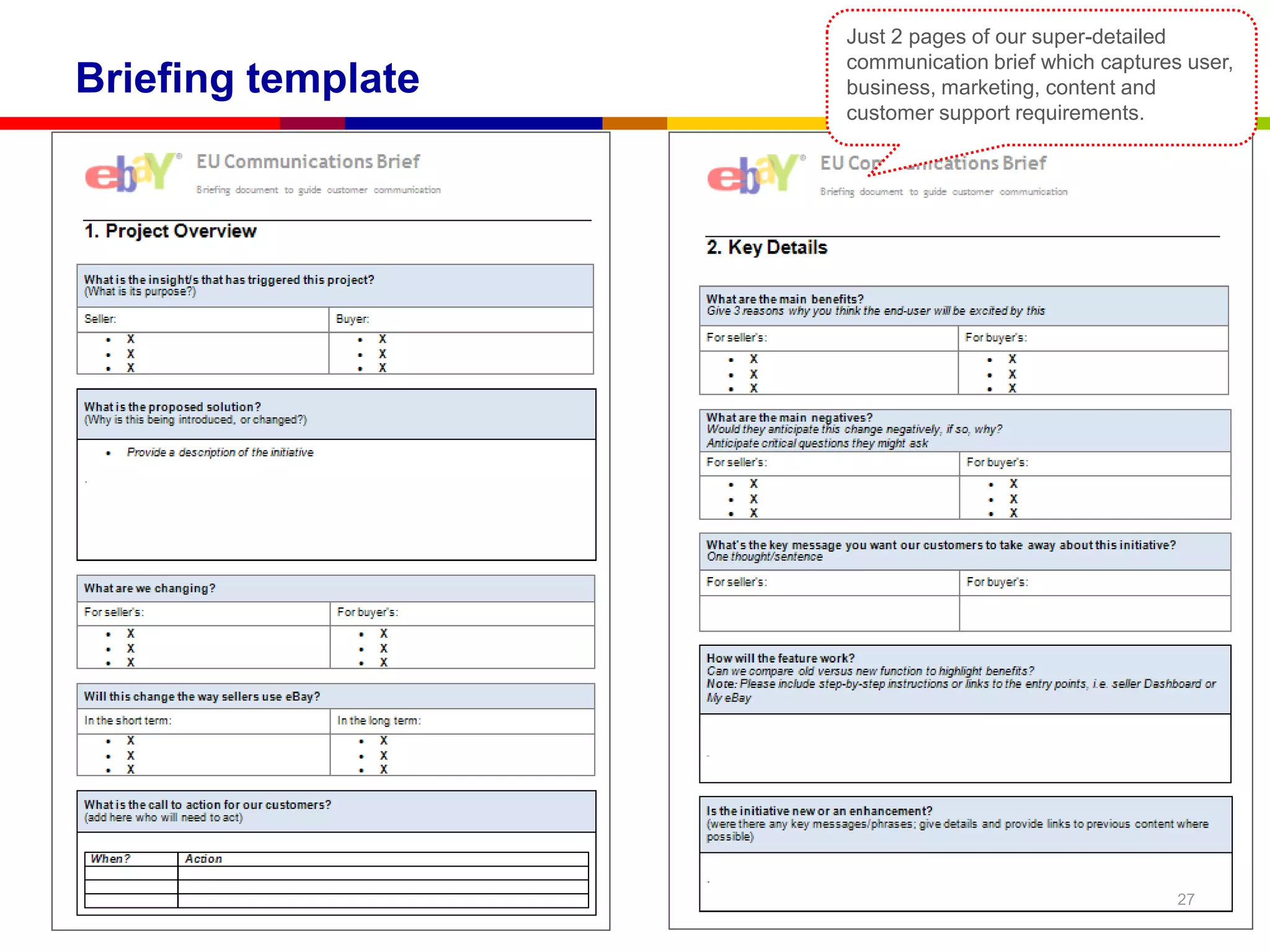

Just 2 pages of our super-detailed
                                                    communication brief which captures user,
Briefing template                                   business, marketing, content and
                                                    customer support requirements.

Implementing a content strategy: An eBay use case                                     27
EU editorial style guide
                                                    Our EU editorila style
                                                    guide was translated and
                                                    implemented with regular
                                                    training sessions.

Implementing a content strategy: An eBay use case                         28
From 2009…

Implementing a content strategy: An eBay use case   29
To 2010: our business seller news

Implementing a content strategy: An eBay use case   30
ADVERT: Come and speak. Listen. Learn.
     Content Strategy Applied conference
     UK, London, Richmond
     1-2 March 2012

Implementing a content strategy: An eBay use case   31
Thanks for listening. Questions?

                           Nikki Tiedtke | EU Senior Content Strategist | eBay GmbH

                           linkedin: http://de.linkedin.com/in/nikkiberlin
                           Mobile: +49.171.36 24 589
                           Skype: nikkitiedtkeebay
                           E-Mail: nikki.tiedtke@web.de

                           Lucie Hyde | Head of Content Management & Strategy - Localisation -
                           Web Development, eBay Europe

                           Mobile: + 44.7870.16 32 80
                           Skype: luciehyde
                           E-Mail: lhyde@ebay.com

Implementing a content strategy: An eBay use case                                                32

Confab 2011: eBay use case - Implementing a Content Strategy within virtual, diverse teams

  • 1.
    Implementing a contentstrategy: An eBay use case Confab – the content strategy conference, Minneapolis 9 – 11 May 2011 Nikki Tiedtke . EU Senior Content Strategist Lucie Hyde . Head of Content Mgmt & Strategy - eBay Europe
  • 2.
    Contents 1. Our needfor a content strategy 2. The context: Business seller communication 3. Key learnings: Implementing a content strategy 4. How we did it: From chaos to content strategy 5. Where are we now? Our content strategy framework 4. Examples of deliverables :: Process: workflows and roles diagrams :: Quality management: Our framework :: Brand opportunity and communication strategy :: Messaging hierarchy and information architecture :: User research and logfile analysis :: Briefing and content templates :: EU editorial style guide Implementing a content strategy: An eBay use case 2
  • 3.
    Our need fora content strategy The project Business seller news campaign for about 500.000 business sellers in EU. Sent 2-3 times a year. The content Content for 12 websites in 7 languages for different formats and channels (online & offline; Marketing, Website, Customer Support). The team 25 people from 11 teams in 5 countries (UK, Ireland, Germany, Switzerland and US). The process An international team. A complex, multi-lingual and multi-channel communication. A fast-pacing environment. But: No clear editorial process and planning, roles, methods or tools. Implementing a content strategy: An eBay use case 3 Images from: http://deutsch.istockphoto.com/file_thumbview_approve/14167360/2/istockphoto_14167360-people-icon-set.jpg
  • 4.
    The context: Businessseller news The topics • New selling formats and tools • New ways of managing inventory • Policy or legal changes The business objectives • Create customer-friendly communication which matches user and business needs. • Drive awareness and adoption of changes. • Build a trusted relationship with sellers, help them to be successful. Implementing a content strategy: An eBay use case 4
  • 5.
    Key learnings: Implementinga content strategy Content strategist as usability consultant: What do • Identify internal and external user needs, before you need? defining processes, strategy and tools. • Address and help resolve conflicting interests. Content strategist as change manager and networker: User / Content strategist Stakeholder • Constantly test & refine processes. • Plan for small step changes to guide teams with different maturity levels into content strategy. • Help build relationships and communication within teams. Content strategist as content lead: • Define and plan editorial roles & responsibilities, process and quality standards. • Create and implement editorial guidelines. • Define and implement quality standards for content. • Manage the editorial process, the copywriters and the quality management process. Implementing a content strategy: An eBay use case 5
  • 6.
    Contents 1. Our needfor a content strategy 2. The context: Business seller communication 3. Key learnings: Implementing a content strategy 4. How we did it: From chaos to content strategy 5. Where are we now? Our content strategy framework 4. Examples of deliverables :: Process: workflows and roles diagrams :: Quality management: Our framework :: Brand opportunity and communication strategy :: Messaging hierarchy and information architecture :: User research and logfile analysis :: Briefing and content templates :: EU editorial style guide Implementing a content strategy: An eBay use case 6
  • 7.
    How we didit: From chaos… Siloed teams with Unclear roles and weak relationships responsibilities No editorial No editorial process guidelines No process No tools and documentation templates or training No quality No match between management business objectives standards and criteria and user needs Implementing a content strategy: An eBay use case 7 Image from: http://cache.gawker.com/assets/images/gizmodo/2008/12/rubber-ducks.jpg
  • 8.
    … to contentstrategy 1 Built strong relationships between teams and identified stakeholder and user needs. 2 Defined editorial roles, responsibilities, process, projectplan, methods and tools. Tested the content strategy for one publishing 3 cycle. Refined it. Used it again. Refined it again. 4 Created editorial guidelines and quality standards based on brand objectives, usability standards and user needs. 5 Implemented the editorial guidelines and quality standards by training 60 EU stakeholders. Tweet! We„re following a content strategy Defined and implemented a quality management process for 6 documenting, measuring and sustaining the quality of content strategy and editorial copy. 7 Next: Implementing this approach in more EU teams! Implementing a content strategy: An eBay use case 8 Images from: http://cache.gawker.com/assets/images/gizmodo/2008/12/rubber-ducks.jpg and http://www.gettyimages.com
  • 9.
    Timeline 2010 2010 Jan Feb Mar Apr May June July Aug Sep Oct Nov Dec Built relationships with teams (11 teams, 5 countries). Defined editorial process Refined process & Finalised and & tested approach. tested again. documented process. Documented usability standards for web content. Analysed regular market & user research. Integrated findings into editorial guidelines. Created editorial Refined guidelines. guidelines for business sellers. Created EU editorial style guide based on Style guide trainings usability standards, user research and business for EU teams seller editorial guidelines. Defined quality standards for content Implementing a content strategy: An eBay use case 9
  • 10.
    Timeline 2011 2011 Jan Feb Mar Apr May June July Aug Sep Oct Nov Dec Refine content strategy based on 2010 learnings. Define and implement a quality management process for content strategy and editorial copy. Test & refine with one publishing cycle. Update and localize EU editorial guidelines. Provide „refresher“ trainings. Create and offer content strategy trainings for EU Marketing & Communication teams. Create a global content strategy framework (global style guides, global content quality management standards, etc). Continuously analyse market & user research. Integrate findings into editorial guidelines. Implementing a content strategy: An eBay use case 10
  • 11.
    Contents 1. Our needfor a content strategy 2. The context: Business seller communication 3. Key learnings: Implementing a content strategy 4. How we did it: From chaos to content strategy 5. Where are we now? Our content strategy framework 4. Examples of deliverables :: Process: workflows and roles diagrams :: Quality management: Our framework :: Brand opportunity and communication strategy :: Messaging hierarchy and information architecture :: User research and logfile analysis :: Briefing and content templates Implementing a content strategy: An eBay use case 11
  • 12.
    Where are wenow? Our content strategy framework Deliverables Deliverables build framework for a repeatable process. • Process, roles and responsibilities documentation. Can be applied to other • Publishing and content project plan projects and teams. • EU editorial style guides based on business Govern Discover objectives, usability standards and user needs. • Style guide and content strategy trainings Deploy Define for all EU stakeholders. • SEO strategy Develop Design • Content and briefing templates Enables us to continuously • Quality management plan incl. quality improve, react fast and standards and criteria. structured within virtual, international teams. Implementing a content strategy: An eBay use case 12
  • 13.
    Repeat and refine:Continuous improvement • Understand business • Define and manage content objectives and user needs. lifecycle (update or end-of-life). • Content inventory and audit. • Quality control: Analyze user research, log file analysis and Govern Discover Identify gaps. • Understand briefing from success metrics. stakeholders. Identify gaps. • Quality assurance of final content in all • Define content channels and formats deliverables and before publishing. • Deploy / launch Deploy Content Strategy Define scope effort. • Define project and online pages and quality management communication. plan. • Brief copywriters. • Create & review copy for all deliverables • Create messaging hierarchy & and channels. Information Architecture. • Use quality standards to assess content quality. Develop Design • Translate business objectives into key messages and call to actions. • Translate & localize copy. • Create “content outline” (rough draft to be approved by stakeholders). Implementing a content strategy: An eBay use case 13
  • 14.
    Contents 1. Our needfor a content strategy 2. The context: Business seller communication 3. Key learnings: Implementing a content strategy 4. How we did it: From chaos to content strategy 5. Where are we now? Our content strategy framework 4. Examples of deliverables :: Process: workflows and roles diagrams :: Quality management: Our framework :: Brand opportunity and communication strategy :: Messaging hierarchy and information architecture :: User research and logfile analysis :: Briefing and content templates :: EU editorial style guide Implementing a content strategy: An eBay use case 14
  • 15.
    Process: Workflows 1/2 Highest Level Major Seller Release Responsibility Map TO BE (Proposed) We defined the overall process A phases first. And then Proposition Confirm the detailed steps Seller information about the proposition to within each phase. be included in the release. Engagement B1 G2 Seller Kick off the J Live to Site process. Set the Post Launch Checkpoint Go/ direction for the Review No Go communication. B2 D2 Marketing F2 Confirm Information Seller E2 Put the marketing Architecture. Trans creation of translated response. Brief Design the RM the DM content into the contributing channel DM structure teams. structure. management C Write copy for D1 E1 F1 Content EU specific Information Get the Micro Put the H I G1 initiatives. Architecture. Sites copy translated Manage Post End of life for QA Content Localise copy Design the translated via content into the Launch Fixes obsolete content for global Micro Site L10n Micro site initiatives. Product F3 Customer Service CS Preparation. Templates, scripts, outbound call schedule Implementing a content strategy: An eBay use case 15
  • 16.
    Process: Workflows 2/2 Example: Detailed process steps in a phase. Implementing a content strategy: An eBay use case 16
  • 17.
    In addition tothe process documentation we defined the Process: Roles and responsibilities detailed roles and responsibilities for each process step. Implementing a content strategy: An eBay use case 17
  • 18.
    Quality management: Ourframework 1/2 Template for our quality management plan. Defines the standard of how we measure quality at eBay for content projects. Can be used for every project. Implementing a content strategy: An eBay use case 18
  • 19.
    Quality management: Ourframework 2/2 Excerpts from our quality management definition which we presented to teams: 1. Definition and 2. What documents we use to assess and control quality. Implementing a content strategy: An eBay use case 19
  • 20.
    Business objectives &editorial strategy Professional seller proposition: Be a trusted, reliable business partner for sellers to enable great profits and sales velocity. Reasons to believe : We will present timely, relevant information, that is easy to understand, helpful, and easy to access… Advanced • Targeted & personalised • Clear and plain language • Easy to use • Correct notice • Focussed on their key needs •Scannable page structure • Concise communication • Visual aids and not just • Reduce clutter channel and format text • Call to action • Optimised for highlighted search engines • Easy to find on eBay … allowing sellers to take action to change their business and sell more efficiently. Excerpt: How we defined editorial guidelines based on our business objectives. The detailed editorial strategy was much more detailed. Implementing a content strategy: An eBay use case 20
  • 21.
    Messaging hierarchy* Call to action What do I need to do? Primary What? message Why? Secondary Who? message How? When? How much? Implementing a content strategy: An eBay use case 21 * From Karen McGrane, Bond art + science: http://www.slideshare.net/KMcGrane/why-ux-design-needs-content-strategy
  • 22.
    Information architecture 1/2 Messaging hierarchy defined our information architecture. From index page… Implementing a content strategy: An eBay use case 22
  • 23.
    Information architecture 2/2 … to single subpage. Implementing a content strategy: An eBay use case 23
  • 24.
    User research: 2009to 2010 comparison* Business sellers Positive feedback 2010 results 2009 results Negative feedback 2010 results 2009 results * From an online survey to a sample of business sellers. Sent after communication launch. Question: Which of the following words or phrases do you think describes all the communications you have received from eBay? Implementing a content strategy: An eBay use case 24
  • 25.
    Logfile analysis The content strategist ensures that we measure key online pages to understand how customers use them. Implementing a content strategy: An eBay use case 25
  • 26.
    Content template: Oneexample Just one of many templates we created. Implementing a content strategy: An eBay use case 26
  • 27.
    Just 2 pagesof our super-detailed communication brief which captures user, Briefing template business, marketing, content and customer support requirements. Implementing a content strategy: An eBay use case 27
  • 28.
    EU editorial styleguide Our EU editorila style guide was translated and implemented with regular training sessions. Implementing a content strategy: An eBay use case 28
  • 29.
    From 2009… Implementing acontent strategy: An eBay use case 29
  • 30.
    To 2010: ourbusiness seller news Implementing a content strategy: An eBay use case 30
  • 31.
    ADVERT: Come andspeak. Listen. Learn. Content Strategy Applied conference UK, London, Richmond 1-2 March 2012 Implementing a content strategy: An eBay use case 31
  • 32.
    Thanks for listening.Questions? Nikki Tiedtke | EU Senior Content Strategist | eBay GmbH linkedin: http://de.linkedin.com/in/nikkiberlin Mobile: +49.171.36 24 589 Skype: nikkitiedtkeebay E-Mail: nikki.tiedtke@web.de Lucie Hyde | Head of Content Management & Strategy - Localisation - Web Development, eBay Europe Mobile: + 44.7870.16 32 80 Skype: luciehyde E-Mail: lhyde@ebay.com Implementing a content strategy: An eBay use case 32
