Thursday 19th May 2022 | P&J Live Aberdeen, UK
#digitnorth
#digitnorth
James McLean
Chief Information Officer,
SSEN Transmission
James McLean CIO – SSEN Transmission
A Five Year Transformation….
Overview
➢ Who are SSEN Transmission?
➢ What we started with, where we are, and where we are going
➢ Organisation and Operating model - Moving to Value Stream delivery
models
➢ Hiring and outsourcing
➢ Culture alignment and executive support for the strategy
• Transmission takes energy from Generators and hands it off to Distribution companies – WE ARE THE MOTORWAYS.
• It is a price control business funded by Ofgem currently in RIIO-T2 which ends April 2026
• Fastest growing Transmission company driven by ScotWind & NOA network expansion
• To meet Network energy targets we will need to capital invest significantly, every year until to 2030
Network Option Assessment (NOA) on Vimeo
10Gw 24Gw
ScotWind Leasing Plans
What we started with, where we are, and where we are going
Build and Fly at the same time
What we started with 2019/20:
• Low core system digitisation; many spreadsheets; huge green field
• Digital transformation plan submission to Ofgem and circa £45m awarded
• Team of 12
• Cloud first strategy – price control is a timebox
• Ramp up and establish pace of programmes and organisation build out
Where we are:
• Team of 30 established – Project delivery, Service Delivery, Analytics, Data
Governance, Operations Technology, Architecture
• Core systems re-platformed to cloud, separated from legacy support
• Value streams established, culture of digitisation underway
• Service Delivery function and Technical support teams growing
• Improving and developing departmental controls, standards, procedures, policy
adherence
Where are we going 24/25:
• Estimated team of 45 – fully staffed to current org design
• Substantial progress of digital programme – agile exploitation on core platforms
• Further strategic plans necessary to support business growth
• Submittal of RIIO-T3 Digital business case
• April 2026 new price control begins
Change
Resources
Change
Resources
Change
Resources
Change
Resources
Change
Resources
VS1: Stakeholders &
Customers
VS2: Capital Projects
VS3: Planning &
Commercial
VS4: Operations
IT VS5: Functions,
Integration, Exploitation
Product Owner
3rd Party
Vendors
Solution
Architect
Security
Architect
Security
Assurance
Delivery Lead
Business
Analyst
Change
Resources
Data &
Analytics
Product Owner Delivery Lead
Business
Analyst
Change
Resources
Data &
Analytics
Product Owner Delivery Lead
Business
Analyst
Change
Resources
Data &
Analytics
Product Owner Delivery Lead
Business
Analyst
Change
Resources
Data &
Analytics
Product Owner Delivery Lead
Business
Analyst
Change
Resources
Data &
Analytics
Solution
Architect
Cyber Program CIO
Head of Cyber
Resilience OT CROT Project (Waterfall)
Solution
Architect
Security
Assurance
3rd Party
Vendors
Digital Program Manager Head of IT Operations
Head of Data
& Analytics
Lead
Solution
Architect

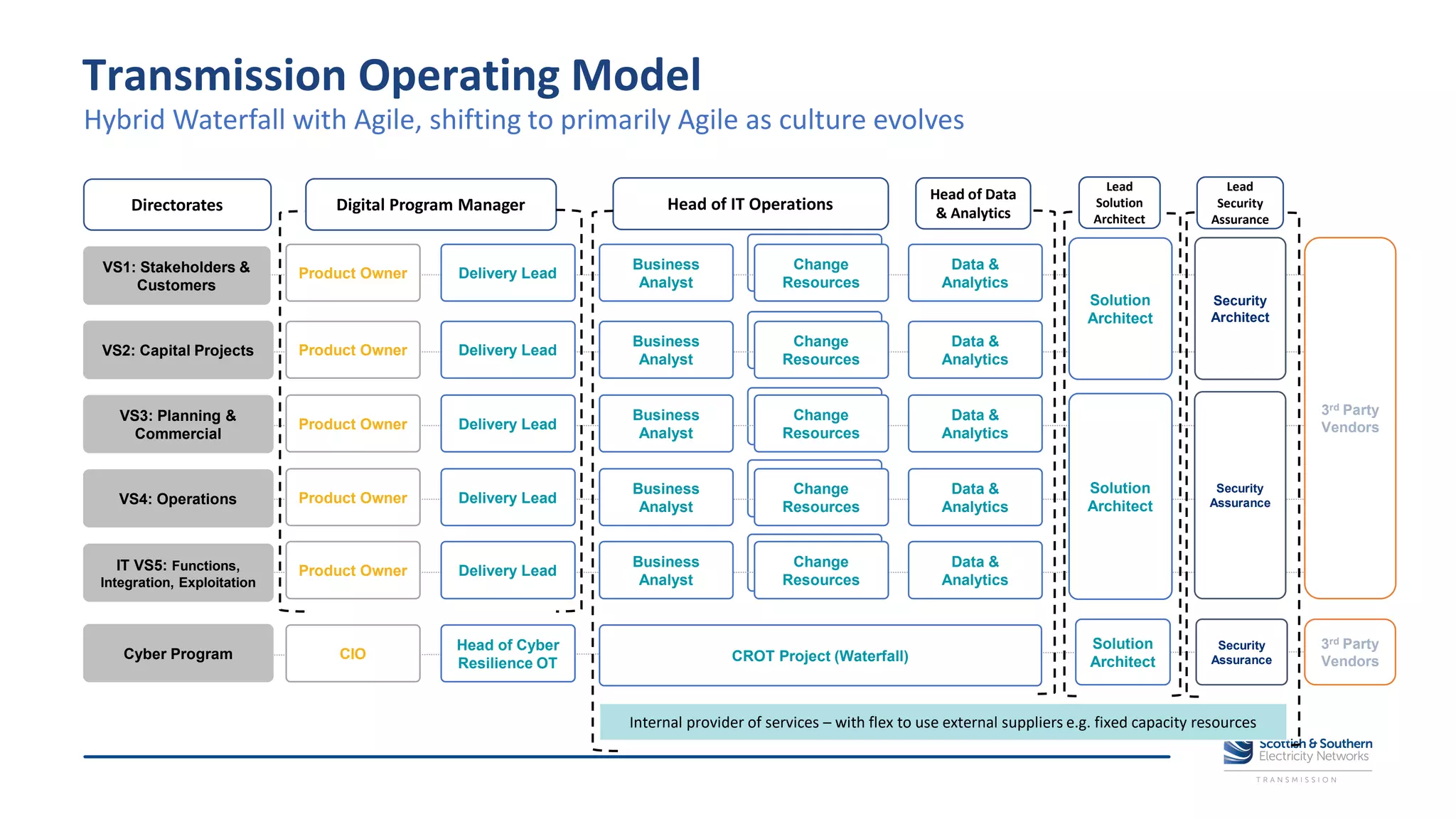

Transmission Operating Model
Internal provider of services – with flex to use external suppliers e.g. fixed capacity resources
Hybrid Waterfall with Agile, shifting to primarily Agile as culture evolves
Lead
Security
Assurance
Directorates
Hiring and Outsourcing
Clear use cases and differentiation
Staffing Strategy:
• Differentiating service roles
• Roles where deep business understanding creates value
• Challenging market conditions
Outsource Strategy:
• Leverage Group provision
• SaaS, PaaS Cloud provision for key systems
• SSE Cloud for Integrated Data Platform
Vendor Strategy:
• Accelerate insight and delivery from expertise
• Long term partnerships with framework suppliers
• Leverage Agile experience and establish MVP’s
Culture Alignment to achieve Digital Transformation
To be successful and realise the value and business outcomes set out in the Digital Vision, the following
needs to be in-place
The Executive Committee must believe in the Digital Vision and Strategy.
Leadership commitment
To deliver at pace we will have the right governance but that the programme requires fiscal flexibility to adapt to circumstance as we
evolve our capability.
Target setting and
governance
Our digital journey is heavily depend on developing the skills and capabilities required to ensure that the organisation can absorb and
embrace the digital change.
Organisational readiness
and communication
Ensure the right people come together from business and IT to deliver each initiative, dedicating the right amount of time to deliver
the outcomes
Implement, accelerate &
scale - “Start small, think
big, act fast”
Digital should become embedded in our ways of working and business as usual to ensure that we are flexible to change at all levels.
Sustain
We need to encourage the awareness of the intrinsic value of data as an asset to the business and stewardship of that data.
Fostering a digital & data
culture
Recognition that the digital investment benefits will be realised not only during T2 but into T3 and beyond; this is a long game.
Business value focused
Value of Digital within SSEN Transmission
Digital Transformation is key to the delivery of SSEN Transmission’s commitments in the RIIO-T2 5 year
plan, as well as meeting the broader digital ambitions of SSE Group
Ofgem: “The fastest route to Net Zero is via Data and Digitalisation”
Optimise Operations
Reduced manual
processing, multiple data
entry and information
retrieval.
Enhanced Customer Experience
Deliver the great stakeholder and
customer experience needed to meet
increased expectations, and in-line with
our peers
Attract & retain talent
Support the growing workforce with the
digital and data skills they need in the
modern world, and providing the
capabilities they need to deliver our
strategic objectives and meet their
personal goals
Increase safety
Through better visibility of our
operations and our people
Readiness for T3
Be better prepared with the
right platforms and processes
to react to the challenges &
opportunities that T3 will bring
Simplify & Standardise
Deliver the capabilities that the business
desire, consolidate existing tools where
needed and developing the platforms to
collaborate effectively with Suppliers to
maximise the value they deliver to SSENT
Improve decision making
(more informed and quicker)
Better, faster, fact-based decision
making at all levels through self-
service reporting & analytics.
Reduce Network Risk
Better data and information to
inform NARM and asset
performance to inform and
optimize investment decisions
Thank you for listening!
11
#digitnorth
Steve Roud
Chief Officer: Digital & Technology,
Aberdeen City Council
Sandie Scott
People Development Manager,
Aberdeen City Council
Digital (R)evolution:
Developing an Open Business Platform for Multi-Agency Working
Digital (R)evolution:
Developing an Open Business Platform for Multi-Agency Working
Chief Officer
of Digital &
Technology
Steve Roud
People
Development
Manager
Sandie
Scott
▪ Setting the vision
▪ From vision to reality
▪ Blending evolution
and revolution to
achieve pace and
stability
▪ Adoption and change
management
The Nature of
Work
The
Workforce
of the
Future
The
Workplace
of the
Future
What are the new and evolving needs
of the city and citizens?
How does this change the work we
do?
Where will our employees
interact with customers?
Where and how can our
employees do their best
work?
What skills and behaviours
will our people need to
thrive?
How might our culture
need to shift?
Aberdeen City Transformation
Multi-Agency
Transformation
&
LOIP
Improvement
ACC
Transformation
Programme
Whole
System
Change
Service Design
(Annual Critical
Path)
The Nature of
Work
The
Workforce
of the
Future
The
Workplace
of the
Future
Aberdeen City Transformation
The Nature of
Work
The
Workforce
of the
Future
The
Workplace
of the
Future
Multi-Agency Transformation &
LOIP Improvement
ACC Transformation Programme
Whole
System
Change
Service Design
(Annual Critical Path)

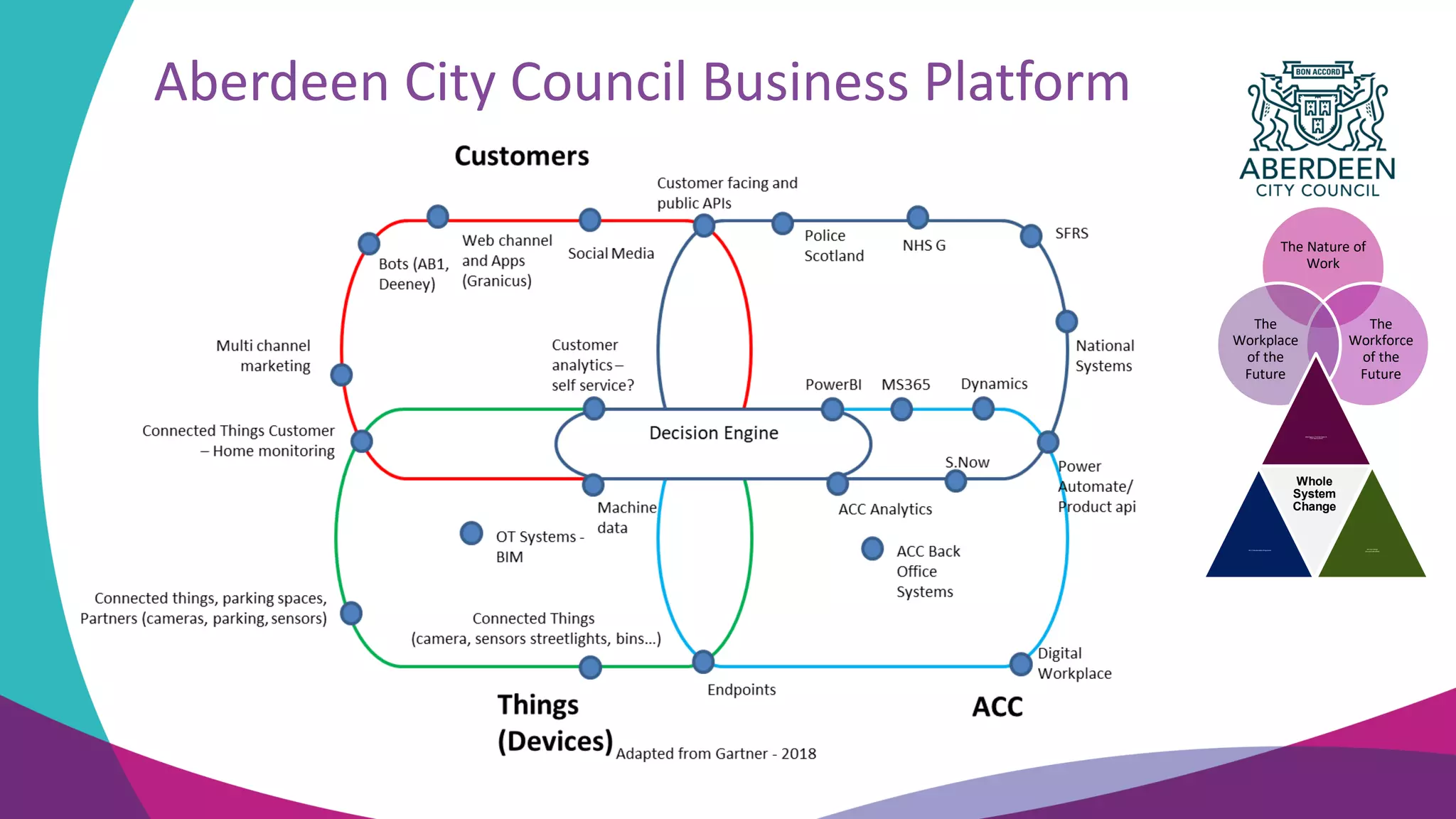

Aberdeen City Council Business Platform
The Nature of
Work
The
Workforce
of the
Future
The
Workplace
of the
Future
Multi-Agency Transformation &
LOIP Improvement
ACC Transformation Programme
Whole
System
Change
Service Design
(Annual Critical Path)
Underlying Platform Components (Customer)
The Nature of
Work
The
Workforce
of the
Future
The
Workplace
of the
Future
Multi-Agency Transformation &
LOIP Improvement
ACC Transformation Programme
Whole
System
Change
Service Design
(Annual Critical Path)

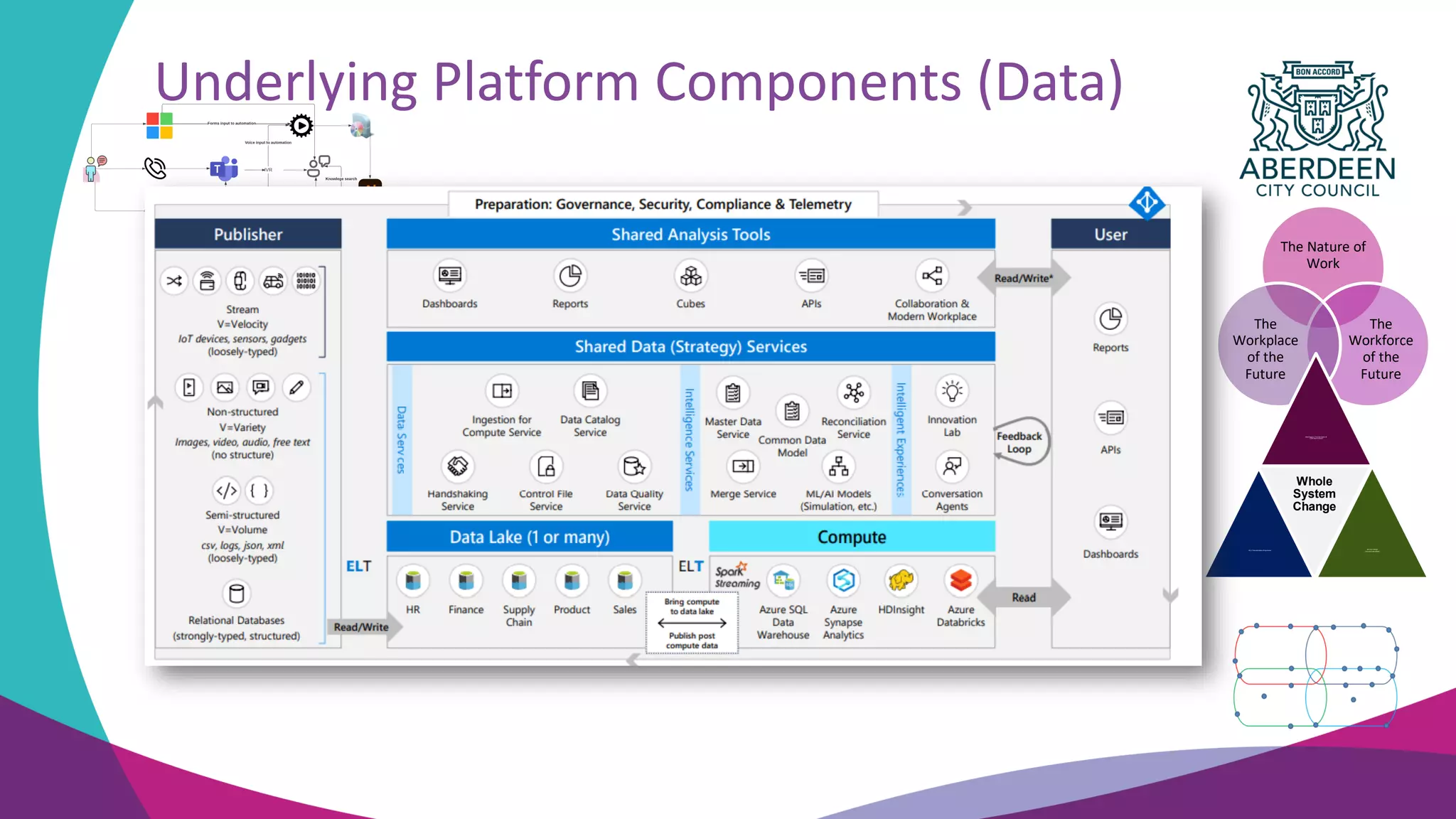

Underlying Platform Components (Data)
The Nature of
Work
The
Workforce
of the
Future
The
Workplace
of the
Future
Multi-Agency Transformation &
LOIP Improvement
ACC Transformation Programme
Whole
System
Change
Service Design
(Annual Critical Path)
Underlying Platform Components (ACC apps)
The Nature of
Work
The
Workforce
of the
Future
The
Workplace
of the
Future
Multi-Agency Transformation &
LOIP Improvement
ACC Transformation Programme
Whole
System
Change
Service Design
(Annual Critical Path)
Aberdeen City Council Transformation

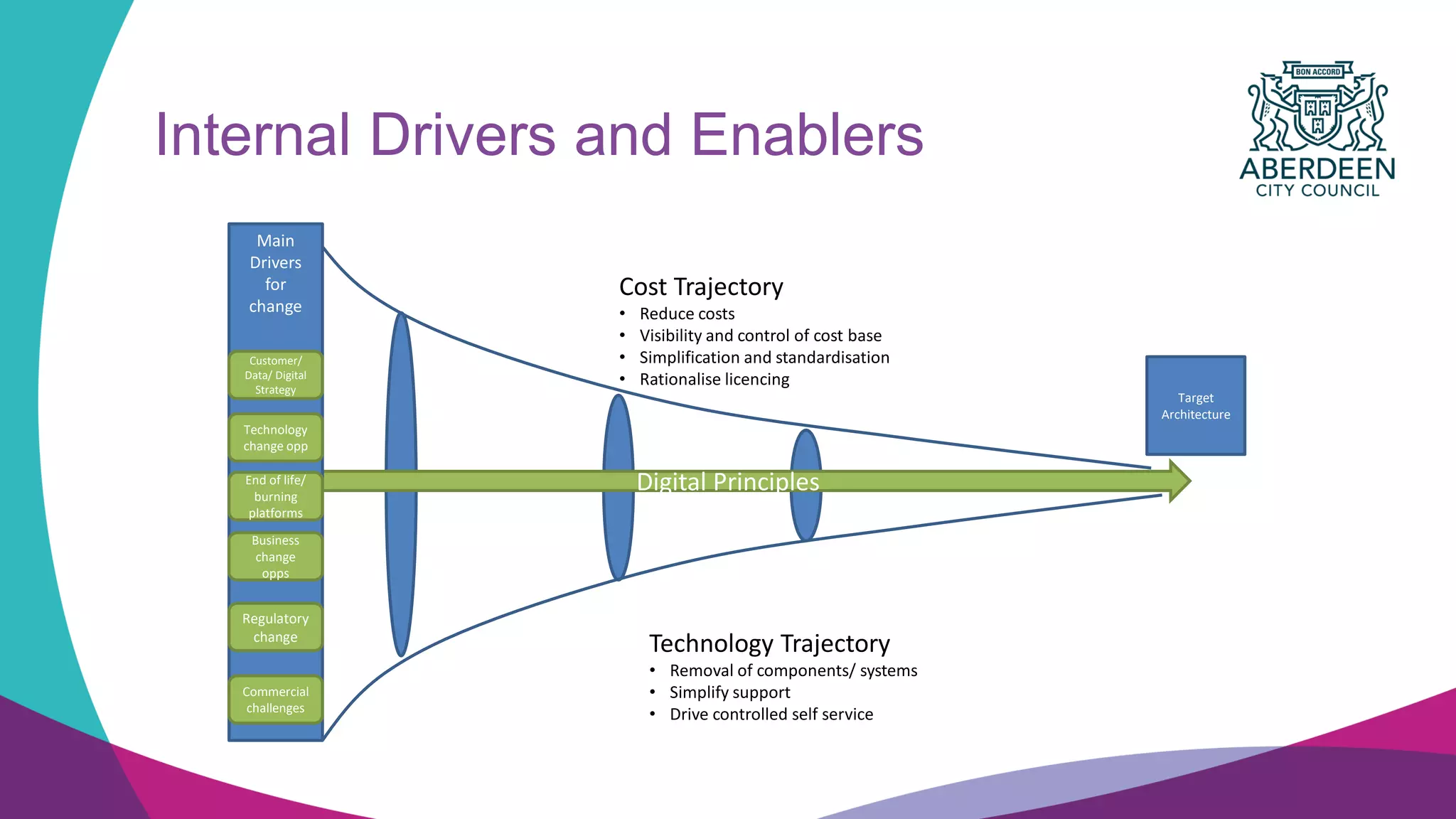

Internal Drivers and Enablers
Digital Principles
Main
Drivers
for
change
Customer/
Data/ Digital
Strategy
Technology
change opp
End of life/
burning
platforms
Business
change
opps
Regulatory
change
Commercial
challenges
Cost Trajectory
• Reduce costs
• Visibility and control of cost base
• Simplification and standardisation
• Rationalise licencing
Technology Trajectory
• Removal of components/ systems
• Simplify support
• Drive controlled self service
Target
Architecture
Driving Innovation
Convergence
App migration
App modernisation
Foundational Strategic Value and Capabilities
Application
Dev
Data
Estate
Smart Apps
(Infused with
pre-built AI)
Intelligent Apps
(Cloud Native)
Data migration
Data modernisation
Advanced Analytics
Data Intelligence
(AI/ML)
Adoption & Change
Management
Our story
How it started…
In partnership with
2019
How it’s going….
Successfully migrated
data to the cloud
Teams sites
established for every
single Cluster and
Service in the Council
An army of Digital
Champions leading
the way
An elite crack squad
of Super Champs
training their peers
Programme for Senior
Managers
Teams, SharePoint,
Yammer and Stream
fully established.

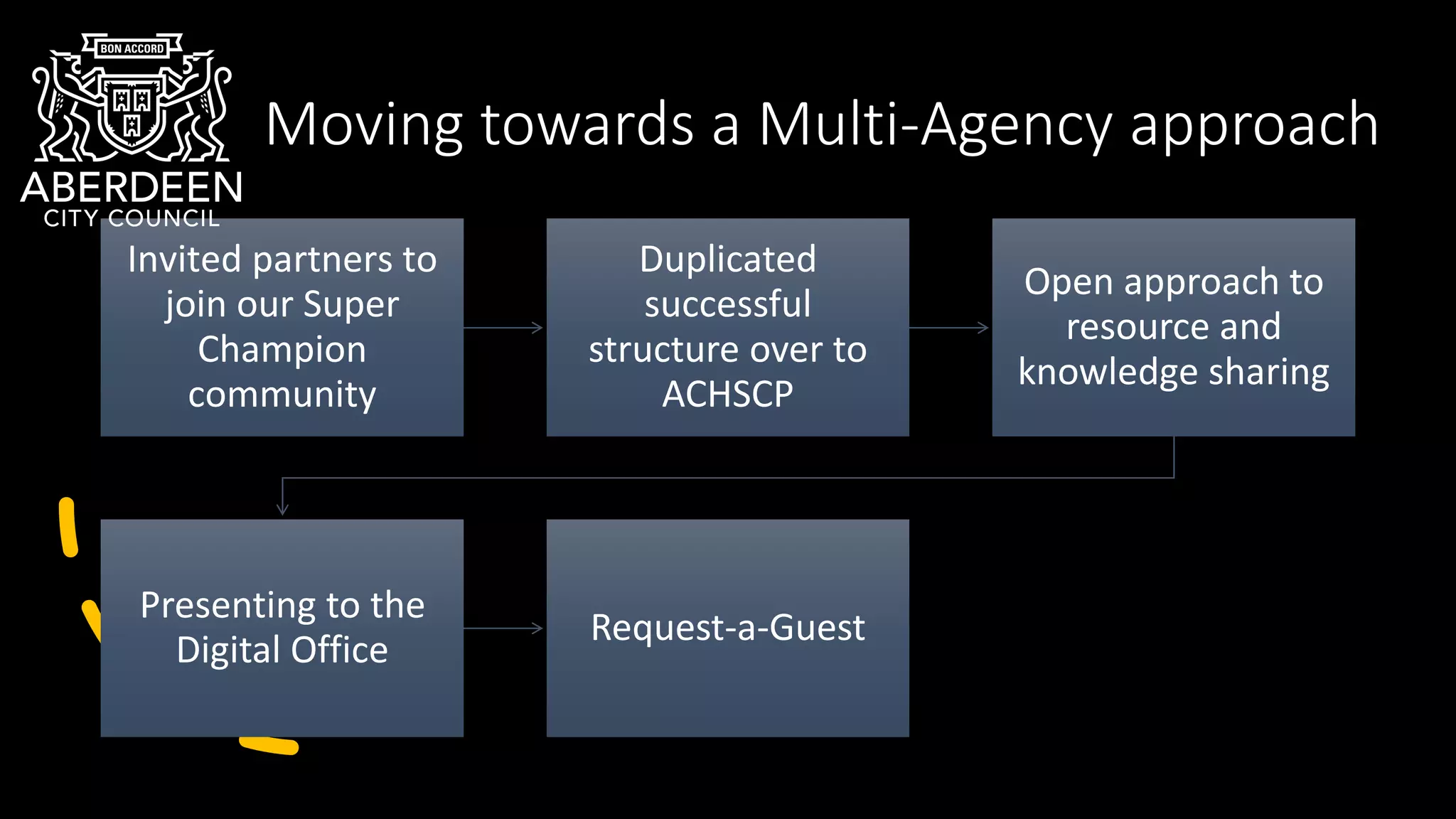

Moving towards a Multi-Agency approach
Invited partners to
join our Super
Champion
community
Duplicated
successful
structure over to
ACHSCP
Open approach to
resource and
knowledge sharing
Presenting to the
Digital Office
Request-a-Guest

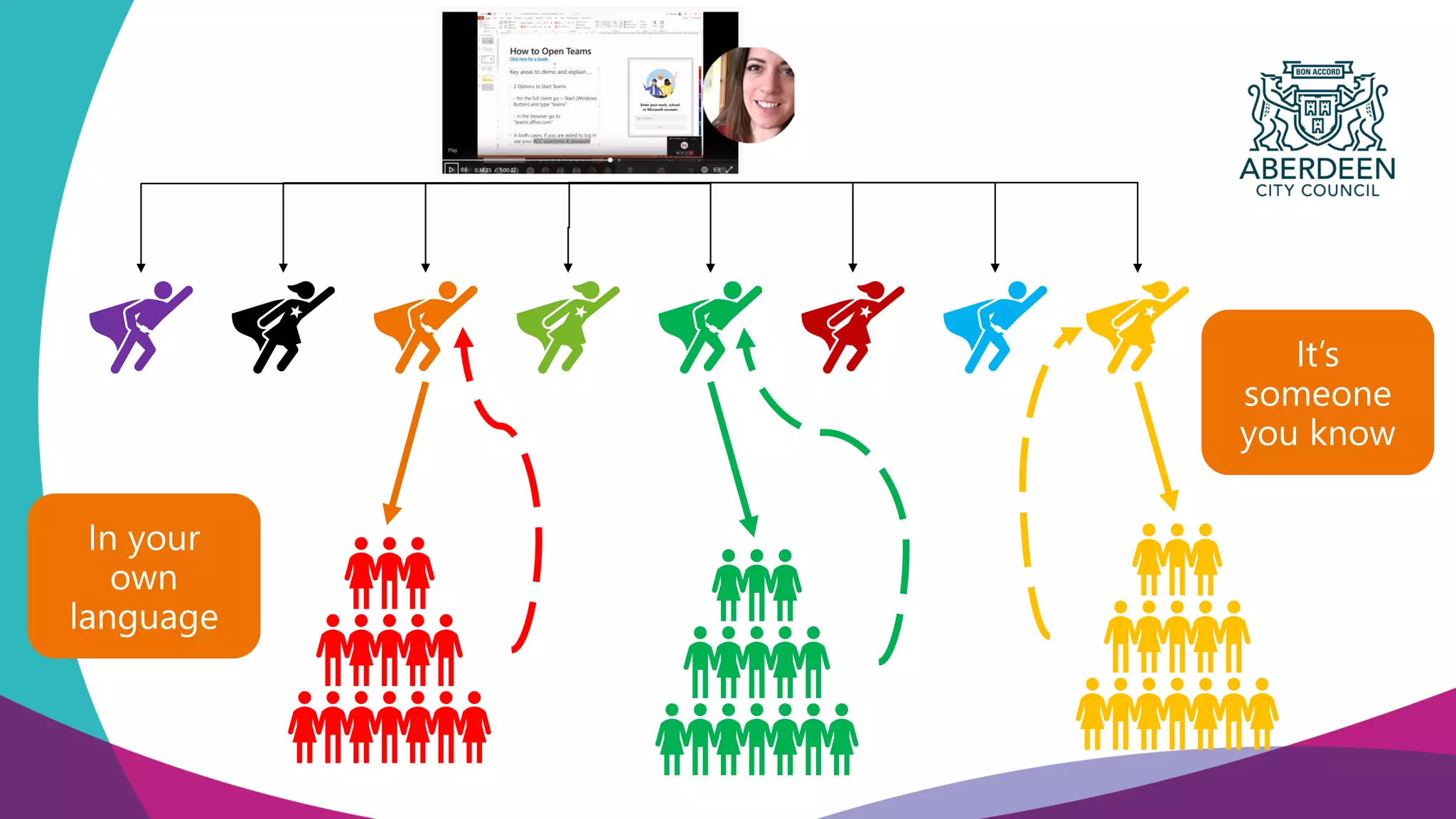

HOW WE DID IT
Training Voice Co-creation
Communications
Empowering
Managers
Executive
Sponsorship
Self-managing
People feel
knowledgeable,
capable and confident
to transition to the
future state
People share their
views and ideas
through established
reliable channels, digital
and face-to-face.
People are collectively
designing solutions to
organization wide
issues or challenges set
by leadership
Communicate the
business reasons of the
change and how the
change will impact
employees
Engage managers and
supervisors toguide
employees through
changes, reinforce and
role model behaviours
at a locallevel.
Create active and
visible executive
engagement
People make change
happen. Spontaneous
self-led groups with
minimal intervention
corporately.
Measurement
Measuring if our
changes are having the
desired impact towards
solving problems and
achieving our business
objectives
Spotlight on: Training
Top things that made a
difference
1. Clear direction and tasks
2. Recruitment
3. Sponsorship and support
4. Reward and recognition
5. Visibility and clarity
Digital (R)evolution:
Developing an Open Business Platform for Multi-Agency Working
Chief Officer of
Digital &
Technology
Steve Roud
People
Development
Manager
Sandie
Scott
#digitnorth
Tanya Knowles
Head of Digital Services,
North Sea Transition Authority
Welcome
Driving innovation through infrastructure reporting
Tanya Knowles, Head of Digital Services
© OGA 2022
This presentation is for illustrative purposes only. The OGA makes no representations or warranties, express or implied, regarding the quality, completeness or accuracy of the information contained herein. All and any
such responsibility and liability is expressly disclaimed. The OGA does not provide endorsements or investment recommendations. Oil and Gas Authority is a limited company registered in England and Wales with
registered number 09666504 and VAT registered number 249433979. Our registered office is at 21 Bloomsbury Street, London, United Kingdom, WC1B 3HF
NSTA’s role
Creating value through strategic approach and focused action
Strategic Vision
Digital Strategies
Early Action
Open data, NDR, website &
access to data
Early Outcomes
Improved compliance,
benchmarking & data quality
Powers
Energy Act 2016
Petroleum Act 1998
Insights
Benchmarking and open data to
encourage positive action
Digital Energy Platform
• Public access
• Downloadable data
• Cloud based
• Integrated with
other data sources
• Authoritative
Geographic Information
Systems (GIS)
Energy transition & integration
Power of data and digital
Digital excellence unlocking numerous insights and opportunities
Exploration
Hydrocarbons & CCS
Transparency
Energy Pathfinder Inclusion
Why did we do it?
Background
• Original purpose of data
• Original process for collection
Potential uses
• Decommissioning, repurposing
• Different attributes required
• Data quality paramount
Using technology
• Spatial formats
• Attribute and spatial-based quality
checks
Expertise
Subject matter
Compliance
Data management
Automation
GIS
Practical implementation of data quality improvement
• Numerous improvements including requiring spatial formats to be reported
• Enforcing data quality by automated checks sending out automated emails
• Working with companies to help them report data correctly
• Positive feedback
Infrastructure reporting
Scope
110
Companies
responding
40+
companies
reporting
data
36 basic
automated
checks
45 Types of
infrastructure
2 workshops 40+
resubmissions
Future plans
More attributes Driving further quality
improvements
Industry involvement
Tighter definitions
More checks Submissions more automated
Thank you
#digitnorth
Malcolm Brown
Energy Subject Matter Expert,
Nasuni
© 2022 Nasuni Corporation - Confidential
The Sanctity of Data
MALCOLM BROWN, ENERGY SUBJECT MATTER EXPERT, NASUNI
45 | © 2022 Nasuni Corporation - Confidential
New Expectations & Demands on IT File Infrastructure
Seismic
Data
High Res
Video
3D
Modelling
Merger &
Acquisition
Exploding
File Data
UNINTERRUPTED
BUSINESS CONTINUITY
Global
Resources
Global
Access
46 | © 2022 Nasuni Corporation - Confidential
Exabytes
Hyperscale Datasets
Future
Terabytes
10 Years Ago
Petabytes
Today
Gigabytes
20 Years Ago
47 | © 2022 Nasuni Corporation - Confidential
A Typical Environment
48 | © 2022 Nasuni Corporation - Confidential
Legacy File Storage Environment
OFFSITE
BACKUP
Admin
Console
DISASTER
RECOVERY
SITE
MPLS/WAN
REMOTE OFFICE REMOTE OFFICE REMOTE OFFICE
Admin
Admin
Admin
Admin
Admin
Admin
MPLS/WAN MPLS/WAN
HQ DATA CENTER
Admin
Console
Admin
Console
Admin
Console
Admin
Console
FILE SERVERS & NAS SILOS
FILE BACKUP SOFTWARE & HARDWARE
Cost &
Complexity
• Capacity Growth
• Data Silos
• Backups
• Mgmt Overhead
?
?
Multi-Site
File Sharing
• File Sync
• Access Anywhere
Ransomware
• Disaster Recovery
?
49 | © 2022 Nasuni Corporation - Confidential
The Shortest Path Possible
5
Mbps
2
Mbps
VDI
VDI
50 | © 2022 Nasuni Corporation - Confidential
Create a Golden Master of all data from day 1 using
Immutable Objects
Immutable Snapshots
Protected
Encrypted Continuous Versions
Indestructible
51 | © 2022 Nasuni Corporation - Confidential
File Data Platform Approach
BACKUP/FAST RECOVERY
PRIMARY FILE STORAGE
DISASTER RECOVERY
FILE SYNC
CAPABILITIES
SINGLE
MANAGEMENT
CONSOLE
GLOBAL FILE
SYSTEM IN OBJECT
STORAGE
CLOUD
ORCHESTRATION
APP& SAAS
INTEGRATIONS
DIFFERENTIATORS
EDGE
CACHING
52 | © 2022 Nasuni Corporation - Confidential
Unstructured Data is Vulnerable
53 | © 2022 Nasuni Corporation - Confidential
Multi-Layered Security Strategy
54 | © 2022 Nasuni Corporation - Confidential
Continuous File Versioning Reduces Recovery Times
Disaster Event
Recovery Point Objective (RPO) Recovery Time Objective (RTO)
Seconds
Lost Data Time to Resume
Minutes Hours Days Weeks
Seconds
Minutes
Hours
Weeks
Synchronous
CDP
Tape Backups
Offsite Tape
Local Tape
Synchronous CDP
Traditional
Modern/Cloud
Snapshots
Snapshots DR Failover
55 | © 2022 Nasuni Corporation - Confidential
- means putting data first and
acknowledging that if something
fatally happens to your
company’s intellectual property
housed within years of file data,
you're putting your entire
organization at risk.
"The Sanctity of Data"
56 | © 2022 Nasuni Corporation - Confidential
- means putting data first and
acknowledging that if something
fatally happens to your
company’s intellectual property
housed within years of file data,
you're putting your entire
organization at risk.
So, what do we do as IT leaders?
"The Sanctity of Data"
#digitnorth
Rotimi Alabi
Founder & CEO,
RAB-Microfluidics
BREAKOUT
A
Copyright RAB-Microfluidics 2022
Version 1.0.
Confidentiality Statement: This document is the property of RAB-Microfluidics R&D Company Limited and is considered to be strictly confidential. It contains information intended only for the person to whom
it is transmitted.
Improving Machine Reliability
with Data-Driven Insight
enabled by Automation
Delivered By
Dr Rotimi Alabi
Copyright RAB-Microfluidics 2022
Motivations
Copyright RAB-Microfluidics 2022
60
The Problem
60
Lubrication related
engine failure
Limitations on
technologies
Costs
Copyright RAB-Microfluidics 2022
61
How we are addressing the problem
61
Copyright RAB-Microfluidics 2022
Industry Challenge and Market Opportunity
£2.1 Bn spent
on breakdown
and downtime
losses.
2.06bn spent
on breakdown
and Downtime
loses
£2.83 Bn spent
to diagnose
failure.
Market Growth CAGR – 8.7%
Analysis automation will add
£400 Mn to testing and analysis
market by 2025 – Markets and Markets
2020
62
Total Market Value - £5.2 Bn
1044 lubrication related engine failures in the
maritime industry in 2020.
Copyright RAB-Microfluidics 2022
The Technology
Copyright RAB-Microfluidics 2022
The Technology
H-Cell Selective Extraction
Laminar Flow
Fluidic interface
Hexane Outlet
Sample Outlet
Oil
Hexane
Hexane
Oil
Hexane
300 𝜇m
Copyright RAB-Microfluidics 2022
Comparison with Standard Methods
Using three oil components :-
• Acid Number
• Base Number
• Insoluble Content
Copyright RAB-Microfluidics 2022
0
1
2
3
4
5
6
0 1 2 3 4 5 6
Microfluidics
Method
(mgKOH/g)
ASTM D664 (mgKOH/g)
1:1 Gradient Fit
95% Confidence Interval
Comparison with Standard Methods: Acid Number
Copyright RAB-Microfluidics 2022
0
10
20
30
40
50
60
70
80
90
0 10 20 30 40 50 60 70 80 90
95% Confidence Interval
1:1 Gradient Fit
IP 276 (mgKOH/g)
Comparison with Standard Methods: Base Number
Microfluidics
Method
(mgKOH/g)
Copyright RAB-Microfluidics 2022
0
0.2
0.4
0.6
0.8
1
1.2
1.4
0 0.2 0.4 0.6 0.8 1 1.2 1.4
ASTM D893 (%)
1:1 Gradient Fit
95% Confidence Interval
Comparison with Standard Methods: Insolubles
Microfluidics
Method
(mgKOH/g)
Copyright RAB-Microfluidics 2022
69
Portable Device Machine Integrated Device
Product Versions
Copyright RAB-Microfluidics 2022
How it works
70
Copyright RAB-Microfluidics 2022
1 2 3 4 5 6 7 8 9 10 11 12 13 14 15 16 17 18 19 20
0.0
1.0
2.0
3.0
4.0
5.0
1 2 3 4 5 6 7 8 9 10 11 12 13 14 15 16 17 18 19 20
Hours
Days
H-Cell
TAN
(mgKOH/g)
1 2 3 4 5 6 7 8 9 10 11 12
0.0
1.0
2.0
3.0
4.0
5.0
1 2 3 4 5 6 7 8 9 10 11 12
Hours
Days
RHS: Starboard Engine
LHS: Portside Engine
Allowable Limit <3.5 mgKOH/g Allowable Limit <3.5 mgKOH/g
Case Study: Marine Shipping Vessel
Copyright RAB-Microfluidics 2022
create
Microfluidic Lab-on-a-chip Technology
Online Analysis/Big Data Generation
Digital Analogue/Twin
Predictive Analytics/Maintenance
Value
• Enhanced production efficiency.
• Better understanding of machinery performance.
• Automation and digitisation of oil analysis.
• Machinery availability.
• Cost savings.
• Predictive analytics and maintenance.
Value Proposition
72
Copyright RAB-Microfluidics 2022
73
Summary
• Platform technology that permits the
real-time analysis of lubricating oil.
• Address unmet need for rapid point-of-
use multi-parameter testing of lubricant
samples.
• Transform lubricating oil analysis by:
o automating conventional processes.
o information for predictive analytics
models and internet of things (IoT)
modules.
Copyright RAB-Microfluidics 2022
Contact Us.
Monday – Friday 08:00 – 17:00
Business Hours
rotimi.alabi@rab-microfluidics.co.uk
E-mail Address
Unit 5
Aberdeen Science & Technology Park
Bridge of Don
Aberdeen AB1 2AB
Building Address
07429 315557
01224 010400
Telephone Number
#digitnorth
John Gonsalves
Principal Field Evangelist,
Aviatrix
BREAKOUT
F
© 2022,Aviatrix All rights reserved.
Secure Cloud Networking, Visibility, and
Multi-Cloud Operations
John Gonsalves
Principal Evangelist
© 2022,Aviatrix All rights reserved.
© 2022,Aviatrix All rights reserved.
© 2022,Aviatrix All rights reserved.
Over 500 Enterprise Customers
60 of the Global Fortune 500
60% in a Single Cloud Today
17,000 Aviatrix Certified Engineers (ACE)
© 2022,Aviatrix All rights reserved.
“Organizations looking for advanced networking functionality
missing from native public cloud providers and/or those that
desire a consistent networking console across multiple public
cloud providers, should shortlist Aviatrix”
Cool Vendors in Cloud Networking
April 16, 2021
© 2022,Aviatrix All rights reserved.
© 2022,Aviatrix All rights reserved.
Secure Cloud Networking
© 2022,Aviatrix All rights reserved.
Private Interconnect
CLOUD 2 CLOUD 3 CLOUD 4
© 2022,Aviatrix All rights reserved.
Private Interconnect
CLOUD 2 CLOUD 3 CLOUD 4
Aviatrix
Controller
Programmatically Leverages and Controls Native Constructs
1
VPC VPC VCN VCN
VPC VPC
VNET VNET
VPC VPC
Available in AWS Marketplace
© 2022,Aviatrix All rights reserved.
Aviatrix
Controller
CLOUD 2 CLOUD 3 CLOUD 4
VPC VPC VCN VCN
VPC VPC
VNET VNET
VPC VPC
Adds Advanced Networking and Security on Top In Each Cloud
2
Region 1
Region 2
Private Interconnect
© 2022,Aviatrix All rights reserved.
Aviatrix
Controller
CLOUD 2 CLOUD 3 CLOUD 4
VPC VPC VCN VCN
VPC VPC
VNET VNET
VPC VPC
Region 1
Region 2
Private Interconnect
Consistent Networking
© 2022,Aviatrix All rights reserved.
Aviatrix
Controller
CLOUD 2 CLOUD 3 CLOUD 4
VPC VPC VCN VCN
VPC VPC
VNET VNET
VPC VPC
Region 1
Region 2
Private Interconnect
Consistent Visibility and Troubleshooting
© 2022,Aviatrix All rights reserved.
Aviatrix
Controller
CLOUD 2 CLOUD 3 CLOUD 4
VPC VPC VCN VCN
VPC VPC
VNET VNET
VPC VPC
Region 1
Region 2
Private Interconnect
Consistent Security
© 2022,Aviatrix All rights reserved.
Aviatrix
Controller
CLOUD 2 CLOUD 3 CLOUD 4
VPC VPC VCN VCN
VPC VPC
VNET VNET
VPC VPC
Region 1
Region 2
Private Interconnect
Consistent Automation
© 2022,Aviatrix All rights reserved.
Other “Multi-Cloud” Solutions
© 2022,Aviatrix All rights reserved.
Security Embedded Into Your Cloud Network
© 2022,Aviatrix All rights reserved.
Aviatrix
Controller
CLOUD 2 CLOUD 3 CLOUD 4
VPC VPC VCN VCN
VPC VPC
VNET VNET
VPC VPC
Private Interconnect
Threat Database
“Malicious IPs”
ThreatIQ with ThreatGuard
“All Seeing” Data Plane
© 2022,Aviatrix All rights reserved.
Aviatrix
Controller
CLOUD 2 CLOUD 3 CLOUD 4
VPC VPC VCN VCN
VPC VPC
VNET VNET
VPC VPC
Threat Database
“Malicious IPs”
ThreatIQ with ThreatGuard
Discovery and
Notification
Critical Threat
Private Interconnect
© 2022,Aviatrix All rights reserved.
Aviatrix
Controller
CLOUD 2 CLOUD 3 CLOUD 4
VPC VPC VCN VCN
VPC VPC
VNET VNET
VPC VPC
Threat Database
“Malicious IPs”
ThreatIQ with ThreatGuard
Discovery and
Notification
Critical Threat
Private Interconnect
© 2022,Aviatrix All rights reserved.
© 2022,Aviatrix All rights reserved.
Network Behavior Analytics – Built Into Your Cloud Network
Secure
Cloud
Networking
Next Gen
Firewalls
Malicious
IPs
Known Threat
Signatures
Network
Behavior
Analytics
Distributed
Inspection
Distributed
Control
New Capability of Aviatrix ThreatIQ™
- Fingerprints workload and traffic characteristics to form baseline
- Custom for every environment
- Identifies and alerts on abnormal network behavior
- Not dependent on signatures or known threat database
- Continuous baselining, ”learns” and improves over time
Baseline
(Normal) Current Behavior
Anomaly detected; Alert Sent
Example Behavior Analysis: Actionable Intelligence that may be an indicator
of Data Exfiltration, Lateral Movement, New Ports/Protocols, DDoS attacks,
Port scan detection, or unencrypted traffic flows
© 2022,Aviatrix All rights reserved.
© 2022,Aviatrix All rights reserved.
TOPOLOGY REPLAY
NETWORK GRAPH
© 2022,Aviatrix All rights reserved.
© 2022,Aviatrix All rights reserved.
© 2022,Aviatrix All rights reserved.
Aviatrix Business Value Across Multiple Teams
Increase Revenue Growth with Business Innovation
• Drive higher revenue and margins from existing customers
• Expand into new markets and quickly onboard new customers
• Faster product time-to-market and revenue
• Accelerate acquisition integrations
Increase Control, Visibility, and Resource Efficiency
• Faster monitoring and troubleshooting, lower MTTR
• Automated provisioning using Terraform and APIs
• Higher efficiency in network engineering and security teams
Bridge the Talent Gap
• Reduce recruiting and training expenses
• Reallocate high-value resources to more strategic functions
• Reduce operational costs by retiring legacy tech debt
Reduce Business Risk
• Identify and Remediate know threats automatically
• End-to-End and high-performance encryption
• Multi-cloud network segmentation
• Consistent blacklisting / whitelisting filtering
• Simplify network audit and compliance
© 2022,Aviatrix All rights reserved.
Accelerate your cloud journey
Aviatrix simplifies cloud networking, security and operational visibility to help customers
meet enterprise requirements that solve real-world business challenges.
Do more with less
Reduce time to market
Reduce the skills gap
Reduce business risk
Common control plane
Distributed repeatable data plane
Advanced network and security
Day 2 operations and visibility
Technical Benefits Business Benefits
World-Class Support and Professional Service
#digitnorth
Sarah Middlemiss
Chief Operating Officer,
Ecometrica
Driving Environmental Improvement
with Digital Transformation and
Space Data
Sarah Middlemiss
COO UK & Europe, Ecometrica
Sustainability – nice to have, or business
critical?
In 2020, 95 Fortune 500
companies have a Chief
Sustainability Officer
Over 600 sustainability
standards to report on
Parallels with other sectors
ESG
Digital
Finance
What are we doing?
REPORT + COMPLY
GHG Accounting Software
What are doing?
MONITOR
Monitoring land based assets from space
What are doing?
LOOK AHEAD
TCFD – Climate Risk Reporting
Ecometrica
Further Info & Contact
Sarah Middlemiss
COO
Tel: +44 (0)131 662 4342
Mob: +44(0)7593 643 056
sarah.middlemiss@ecometrica.com
#digitnorth
Neil Burnett
Chief Technical Officer,
Arria
#digitnorth
Caroline Laurenson
Managing Director,
TL Tech
Click to edit Master title text
Click to edit Master subtitle text
Insert Date
What is a brand?
www.tltechsmart.com
Click to edit Master title text
Click to edit Master subtitle text
Insert Date
Our Story
www.tltechsmart.com
Click to edit Master title text
Click to edit Master subtitle text
Insert Date
Voice Trends - Control
Ref. Statista
Alexa
Compatible
Devices
2020+
~4000
>100,000
2017 www.tltechsmart.com
Click to edit Master title text
Click to edit Master subtitle text
Insert Date
Voice Trends - Search
www.tltechsmart.com
Click to edit Master title text
Click to edit Master subtitle text
Insert Date
Voice Trends - Commerce
www.tltechsmart.com
Ref. PWC Global Consumer Insights Pulse Survey
Click to edit Master title text
Click to edit Master subtitle text
Insert Date
Voice Trends - Commerce
www.tltechsmart.com
Ref. PWC Global Consumer Insights Pulse Survey
Click to edit Master title text
Click to edit Master subtitle text
Insert Date
Characteristics of a Voice Interface
www.tltechsmart.com
Click to edit Master title text
Click to edit Master subtitle text
Insert Date
Benefits of a Voice-First Strategy
www.tltechsmart.com
Click to edit Master title text
Click to edit Master subtitle text
Insert Date
Designing for Alexa
Tutorials:
▪ Alexa Skills Kit
▪ Alexa Developers on YouTube
▪ Dabble Lab
▪ Codecademy
Further community support:
▪ Github Alexa
▪ Alexa Presentation Language for creating display
graphics – APL Ninja
▪ Alexa community Slack group
TL Tech Voice strategy blog piece www.tltechsmart.com
Click to edit Master title text
Click to edit Master subtitle text
Insert Date
Thank You
For further information:
www.tltechsmart.com
caroline@tltechsmart.com
https://www.linkedin.com/in/caroline-laurenson/
https://www.createyourkindspace.com/
#digitnorth
Mark Stephen
Journalist & Broadcaster,
BBC Scotland
Deryck Mitchelson
Chief Information Security Officer,
Check Point
Mark Mitchell
Technical Evangelist
for the Office of the CTO,
Check Point
124
©2022 Check Point Software Technologies Ltd.
Deryck Mitchelson | Chief Information Security Officer
Mark Mitchell | Technical Evangelist for the office of the CTO
19/05/2022
Ransomware, Recovery and Response
125
©2022 Check Point Software Technologies Ltd.
• Ransomware
• Recovery
• Response
Agenda
126
©2022 Check Point Software Technologies Ltd.
2021 Threat Landscape was exceptionally dangerous
2022 already looking CONSIDERABLY worse
Ransomware
APT
SW vulnerabilities
Supply chain
*According to ThreatCloud
Every month
10’s of millions of attacks
400K zero days*
Nazar
Naikon
APT
Nation state
May Mar
Microsoft
Exchange
Server
Rampant
Kitten
Nation state
Sep
MDM
Maze
Apr
Ryuk -
HealthCare
Oct
Shopping
month
phishing
Pay2Key
Nov
Qbot
Aug
Nation state
Vicious
Panda
Mar
Azure
Cloud
Jan
HealthCare
Jan
TikTok
Philips
lightbulb
Feb
Covid-19 -
first broad
phishing
campaigns
Microsoft
SigRed
Jul
Colonial
Pipeline
May
Zoom
GuLoader
Jun Dec
Sunburst /
SolarWinds
Nation state
Following
Microsoft
Exchange
Server
Codecov
Apr
2020 2021
APOMacro
Sploit
APT34
Feb
Kaseya /
REvil
Jul
JBS
Jun
Achilles
127
©2022 Check Point Software Technologies Ltd.
The State of the Planet
128
©2022 Check Point Software Technologies Ltd.
Ransomware
129
©2022 Check Point Software Technologies Ltd.
Ransomware – The Ever Increasing Threat
April 2022
130
©2022 Check Point Software Technologies Ltd.
Average Ransomware Costs have doubled in 2021
National Security Threat
Following the Colonial Pipeline attack
The U.S. Department of Justice defined
ransomware as a national threat,
placing it at the same priority level as
terrorism.
Average downtime in 2021 following a
ransomware attack is 10 days.
By 2031, the cost of ransomware
incidents could surpass $265 billion.
131
©2022 Check Point Software Technologies Ltd.
Recovery
• Discovery
• People
• Process
132
©2022 Check Point Software Technologies Ltd.
Breaches are Inevitable?
“… massive institutional beaches don’t need to happen as often as
they do. Many occur not because of complex and sophisticated
hacking, but because organisations have made basic and potentially
avoidable mistakes in implementing their security schemes …”
– Lily Newman, Wired.com, 2018
133
©2022 Check Point Software Technologies Ltd.
Where They Fully Prepared? Are we TO COMPLACENT?
Hacker group
published 9GB of
source code for
250 projects
stolen from
Microsoft
including Bing,
Cortana
March ‘22
Hacker leaks
128GB of
leaded files
from Amazon
streaming
service Twitch
October ‘21
Phishing email
allowed hacker
group to deliver
ransomware
payload shutting
down all 526
shops.
April ‘22
Hacker group
published 190GB of
confidential data
including source
code for boatloader
of newer devices.
Mar ‘22
Hacker group
published 20GB of
confidential data and
71,000 employee
credentials
Feb ‘22
134
©2022 Check Point Software Technologies Ltd.
Response
135
©2022 Check Point Software Technologies Ltd.
Cyber Hygiene Should be an Immediate Priority
• Identify key services, products and assets
• Develop and exercise incident response plan
• Establish cyber awareness and education programme
• Secure backups and regular restoration regime
• Enforce least privilege and full auditing
• Prioritise patch and change management, vulnerability scanning
• Map cyber risks to business priorities and impact
• End-to-end network security and monitoring
• Multi-factor authentication enforcement
136
©2022 Check Point Software Technologies Ltd.
Lessons Learnt from SEPA Ransomware Attack
• Identify key services, products and assets
• Develop and exercise incident response plan
• Establish cyber awareness and education programme
• Secure backups and regular restoration regime
• Enforce least privilege and full auditing
• Prioritise patch and change management, vulnerability scanning
• Map cyber risks to business priorities and impact
• End-to-end network security and monitoring
• Multi-factor authentication enforcement
Finding No 5
Finding No 26 -29
Finding No 17- 20
Finding No 34 - 35
Finding No 9 - 13
Finding No 14 - 16
Finding No 36 - 41
Finding No 25 - 29
137
©2022 Check Point Software Technologies Ltd.
Lessons Learnt from SEPA Ransomware Attack
138
©2022 Check Point Software Technologies Ltd.
Elevating Security Narrative to the Board
Cyber Risks
Technical Jargon
Metric Reporting
Policy and Compliance Reporting
Investment Requests
Skills Shortage
Business Risks
Executive Business Language
Effectiveness and Efficiency Reporting
Business Impact
Enabling Business Priorities and ROI
Automation Strategy and Succession Planning
139
©2022 Check Point Software Technologies Ltd.
Consolidation Prevention Strategy
Single
Framework
Unified Policy
Asset Centric
Shared
Configuration
Shared
Intelligence
Single Pane
of Glass
140
©2022 Check Point Software Technologies Ltd.
• Ransomware
• Recovery
• Response
141
©2022 Check Point Software Technologies Ltd.
deryckm@checkpoint.com
www.linkedin.com/in/deryckmitchelson/
markmi@checkpoint.com
https://www.linkedin.com/in/mark-mitchell-5311119/
#digitnorth
Susan Krueger
Senior Project Manager: Health Informatics
Centre,
University of Dundee
BREAKOUT
B
PICTURES
Enabling large-scale medical
image data research
19th May 2022
DIGIT North Innovation Summit
Susan Krueger, PICTURES Project Manager skrueger001@dundee.ac.uk
Project website: https://www.imageonamission.ac.uk/
Overview
PICTURES
InterdisciPlInary Collaboration for efficienT and effective Use of clinical images in big health care
RESearch (PICTURES)
About
Overcoming the challenges of providing access to population scale, routinely collected health
and imaging data for AI development whilst protecting patient confidentiality
Scope
▪ the Project
▪ the Problem
▪ the Solution
PICTURES | the Project
PICTURES | the Project
Context
▪ InterdisciPlInary Collaboration for efficienT and effective Use of clinical images in big health
care RESearch (PICTURES)
▪ Medical Research Council (MRC) funded, 5-year programme of work
▪ Collaboration between the University of Dundee (UoD), University of Edinburgh (UoE),
Abertay University, Public Health Scotland (PHS) and industry partner Aidence B.V.
▪ Effective start/end dates are 1st August 2019 to 31st July 2024
PICTURES | the Project
Motivation
▪ Linked, de-identified population level data
▪ Opportunity for very large-scale studies
▪ Wide range of disease areas
▪ Improved diagnostic accuracy
▪ New detection methods
A TRE is a Trusted Research Environment. Also known as ‘Data Safe Havens’, TREs
are highly secure computing environments that provide remote access to health data
for approved researchers to use in research that can save and improve lives.
What is a TRE?
TREs help make research
efficient, collaborative and
cost effective, providing rich
data that enables deep insights
which will go on to improve
healthcare and save lives.
TREs provide approved
researchers with a single
location to access valuable
datasets. The data and analytical
tools are all in one place, a bit
like a secure reference library.
How is my data safeguarded?
TREs make research safer.
Making data available through
a TRE means that people can be
confident that their personal
health data is accessed securely
and their privacy protected.
Learn more about TREs and discover examples of how TREs
are being used to enable life-saving health research.
Health data should always be kept safe and secure, and used responsibly
to ensure privacy. Heath Data Research UK ensures these high standards
are met by promoting the use of the ‘Five Safes’ model across all TREs.
Learn more about TREs
Why are they important?
Safe People
Only trained and specifically accredited
researchers can access the data
Safe Projects
Data is only used for ethical, approved research
with the potential for clear public benefit
Safe Data
Researchers only use data that have been
de-identifed to protect privacy
Safe Outputs
All research outputs are checked to ensure
they cannot be used to identify subjects
Safe Settings
Access to data is only possible using secure
technology systems – the data never leaves the TRE
PICTURES | the Project
Core Programme
▪ increasing the capabilities of Safe Havens to support emerging technologies and new
data types (images)
▪ building on existing measures, in place to maintain the trust of the public that their
personal health data is used for the benefit of patients and / or the population as a
whole
▪ 9 work packages:
▪ metadata for complex cohort building
▪ scalability and automation
▪ environments and tools for researchers
▪ speeding it all up
PICTURES | the Project
Exemplar 1
Developing a multivariable lung nodule malignancy risk prediction model
for incidental lung nodules using both imaging markers and clinical data.
Exemplar 2
Developing an algorithm to predict individual risk of dementia using MRI
brain scans, genetic data and other longitudinal health records.
Both exemplars will determine new information from routinely collected
data that would otherwise have been ignored. Predicting and therefore
treating diseases at an early stage improves patient outcomes and reduces
the cost to the NHS.
CT chest scans
MRI brain scans
PICTURES | the Project
Data Science and Engineering Research Questions
How to build
research relevant
Cohorts: Messy,
unstructured,
identifiable data!
How to handle Big
Data: scaling
How can we
protect patient
data?
Natural
Language
Processing
Machine
Learning and
classification
methods
Hardware and
Software
optimisation
methods: Next
Generation Safe
Haven
Cybersecurity
research
PICTURES | the Problem
Info model taken from https://dcm4che.atlassian.net/wiki/spaces/d2/pages/1835038/A+Very+Basic+DICOM+Introduction
DICOM
▪ Digital Imaging and Communications in Medicine standard
Radiologists communicate their
findings to the referring clinician
through text-based Radiology
Reports (aka Structured Reports).
PICTURES | the Problem
PACS
▪ Picture Archiving and Communication System (PACS)
▪ Central archive
▪ Regional Health Boards
▪ Single PACS for Radiology
▪ Relatively stable population
▪ Unique healthcare identifier
North Region
East Region
West Region
PICTURES | the Problem
Research Copy 2010-2018
Modality Total count of images Live
CT 1,551,835,095
MR 475,172,769
PT 34,731,015
SR 27,539,556
CR 21,131,886
XA 7,746,882
RF 7,292,660
DX 6,274,075
MG 2,348,114
NM 1,222,818
PX 225,726
IO 100,608
PICTURES | the Problem
Pixel Data
Images can contained burned in Personally Identifiable Information (PII)
PICTURES | the Problem
Table taken from https://towardsdatascience.com/understanding-dicom-bce665e62b72
DICOM Metadata
Data elements or ‘tags’ in the Header contain values like name, ID, etc., and the image pixel data.
PICTURES | the Problem
Radiology reports are designed to be both
machine and human readable, with
information organised and hierarchical.
Image taken from https://www.dicomstandard.org/docs/librariesprovider2/dicomdocuments/wp-cotent/uploads/2018/10/day2_s7_dicom_structured_reports_d-clunie.pdf?sfvrsn=d4e2b344_4
Structured Reports
PICTURES | the Problem
Handling Data at Scale
https://www.researchgate.net/publication/239743213_Digital_imaging_in_radiology_practice_An_introduction_to_few_fundamental_concepts
PICTURES | the Solution
DE-IDENTIFY and PSEUDONYMISE
PACS
Researcher VM with
tools to view and
manipulate images
Study-specific
Image Metadata
and Pixel Data
(Project Ids)
BUILD COHORT
Research co-ordinators
Cohort builders
Researchers
Disclosure
Control
Preamble
Header
Pixel Data
DICOM DE-IDENTIFY and TRANSFORM
IDENTIFIABLE ZONE DE-IDENTIFIED ZONE ANALYTIC ZONE
System Administrators
De-identification Analysts
Scottish Medical Imaging (SMI)
A microservices architecture
For information on SmiServices go to https://github.com/SMI/SmiServices
PICTURES | the Solution
Complex Cohort Building
Three methods of feature extraction
1. DICOM Tags 2. Natural Language Processing 3. Autoencoder
Image taken from http://www.dclunie.com/pixelmed/DICOMSR.book.pdf
Simple example of a DICOM Structured Report
PICTURES | the Solution
Complex Cohort Building
Three methods of feature extraction
1. DICOM Tags 2. Natural Language Processing 3. Autoencoder
Research Data Management Platform (RDMP)
https://github.com/HicServices/RDMP/
Semantic Search System for Electronic Health Records
(SemEHR) https://pubmed.ncbi.nlm.nih.gov/29361077/
PICTURES | the Solution
Protecting Patient Confidentiality
Disclosure control – it’s all about the layers!
• Legal
• Procedural
• Technical
• Human
GRAIMatter, a HDR UK funded sprint:
• Aim: a range of tools and methods to support TREs to
assess output from AI methods for potentially identifiable
information, investigate the legal and ethical implications
and controls, and produce a set of guidelines and
recommendations to support all TREs with export
controls of AI algorithms.
GRAIMatter – a DARE UK Sprint project https://dareuk.org.uk/sprint-exemplar-project-graimatter/
PICTURES Programme
Scottish Medical Imaging (SMI) Service
▪ a national resource for the provision of images and associated report data to researchers
▪ may be linked to other available pseudonymised datasets
▪ launched in April 2022
▪ small number of high impact research studies already underway
▪ aims to continually develop and grow in the coming years
▪ https://www.isdscotland.org/Products-and-Services/eDRIS/Scottish-Medical-Imaging-Service/
Acknowledgments
Acknowledgments
▪ Farr Institute of Health Informatics Research and Dundee University Medical School.
▪ Medical Research Council (MRC) grant No. MR/M501633/1 (PI: Andrew Morris) and the Wellcome Trust grant No. WT086113 through the Scottish Health
Informatics Programme (SHIP) (PI: Andrew Morris).
▪ MRC and EPSRC (grant No. MR/S010351/1) and the Chief Scientist Office of the Scottish Government Health and Social Care Directorates via a leverage grant
made to Farr Scotland, and the Scottish Government through the “Imaging AI” grant award.
▪ This work was supported by Health Data Research UK, which receives its funding from HDR UK Ltd (HDR-5012) funded by the UK MRC, Engineering and
Physical Sciences Research Council, Economic & Social Research Council, Department of Health and Social Care (England), Chief Scientist Office of the Scottish
Government Health and Social Care Directorates, Health and Social Care Research & Development Division (Welsh Government), Public Health Agency
(Northern Ireland), British Heart Foundation (BHF), & the Wellcome Trust.
Further reading
An extensible big data software architecture managing a research resource of real-world clinical radiology data linked to other health data
from the whole Scottish population Nind T, Sutherland J, McAllister G, Hardy D, Hume A, MacLeod R, Caldwell J, Krueger S, Tramma L,
Teviotdale R, Abdelatif M, Gillen K, Ward J, Scobbie D, Baillie I, Brooks A, Prodan B, Kerr W, Sloan-Murphy D, Herrera JFR, McManus D, Morris
C, Sinclair C, Baxter R, Parsons M, Morris A, Jefferson E. Gigascience. 2020 Sep;9(10) . doi:10.1093/gigascience/giaa095. PMID: 32990744;
PMCID: PMC7523405.
Health Informatics Service
University of Dundee
Mail Box 15
Ninewells Hospital and Medical School
Dundee
DD1 9SY
01382 383102
dundee.ac.uk/hic
hicservices-admin@dundee.ac.uk
Thanks for
Listening!
#digitnorth
Mike Caiger
Senior Systems Engineer,
Zerto
BREAKOUT
E
Ransomware Recovery with Zerto
Mike Caiger – Senior Systems Engineer at Zerto
• Ransomware Challenges
• Zerto architecture
• Ransomware Recovery Scenarios
Agenda
Ransomware Challenges
Ransomware
$265B estimated cost of
ransomware by 2031
Unplanned/Planned
Disruptions
62.9% organizations have
suffered a disruption
Cloud Complexity
By 2025, 100 zettabytes of
cloud data
Need 24x7: no downtime and no data loss
TOP CUSTOMER CHALLENGES
BEYOND THE COST OF RECOVERY
21 days
average disruption period of an attack
66%
of victims suffered significant revenue loss
25%
of victims suffered a period of business closure
$1.85 million
average cost of ransomware
recovery
It’s not a matter of if,
but when.
2
4 6
3
Continuous
user/admin
education
Never think your
organization is
impenetrable
Test recovery plans
to prove RTOs and
RPOs
Keep systems
patched and
antivirus updated
1
5
Harden data
protection
solutions
Take advantage
of 3rd party
expertise
BEST PRACTICES FOR PREVENTION AND PREPARATION
Guide for Cybersecurity Event Recovery
Data Protection
Where Does Data Protection Come In?
Identify Protect
Detect Cyber
Event
Respond to
Cyber Event
Remediate
Root Cause
Tactical
Recovery
Phase
Strategic
Recovery
Phase
Figure 3-1: NIST SP 800-184 Guide for Cybersecurity Event Recovery Relationship with the NIST CSF
Continuous Data Protection
Resume in minutes to
seconds before an attack
Ransomware
Recovery
Foolproof recovery with
fastest RTO and RPO
Disaster
Recovery
Freedom to innovate
across clouds
Multi-Cloud
Mobility
CONTINUOUS PROTECTION
Any App, Any Cloud, Any Threat
Architecture
True Continuous Data
Protection
▸ No production impact
▸ No scheduling, snapshots, or agents
▸ Hardware, Storage & Cloud Agnostic
▸ Always-on, always protected
NEAR-SYNCHRONOUS
REPLICATION
Storage
of your choice
Software-only,
simple deployment
Protect on-premises, to the cloud,
or both simultaneously
▶︎ SIMPLICITY AT SCALE
▶︎ HYBRID AND MULTI-CLOUD
▶︎ CONTINUOUS DATA PROTECTION
GRANULAR
POINT-IN-TIME
RECOVERY WITH THE
ZERTO JOURNAL
Legacy vs. Journal-based Recovery
10:00:00 backup
Up to 24 hrs data loss
6:00:00 snapshot
Up to 4 hrs data loss
9:59:55
Rewind within
seconds
10:00:00
Disaster hits
▶︎ SIMPLICITY AT SCALE
▶︎ HYBRID AND MULTI-CLOUD
▶︎ CONTINUOUS DATA PROTECTION
▸ Recover in minutes to seconds
before an attack or disruption
▸ Fastest RPOs and RTOs
▸ Neutralize ransomware threats
Applications recovered as a single entity
DB
Server
App.
Server
Web
Server
File
Server
2:48:00 AM 2:48:05 AM 2:48:10 AM 2:48:15 AM 2:48:20 AM
DB
Server
App.
Server
Web
Server
File
Server
DB
Server
App.
Server
Web
Server
File
Server
DB
Server
App.
Server
Web
Server
File
Server
DB
Server
App.
Server
Web
Server
File
Server
▸ Write order fidelity across entire
multi-VM application stack
▸ No staggered backup windows
▸ All copies kept in app-centric
groups
APP-CENTRIC
RECOVERY
▶︎ SIMPLICITY AT SCALE
▶︎ HYBRID AND MULTI-CLOUD
▶︎ CONTINUOUS DATA PROTECTION
Scenario 1
All VMs get encrypted
P R O D U C T I O N
V C E N T E R Z V M
P H Y S I C A L
S T O R A G E
H O S T
V R A
V M
V M
D A T A S T O R E S
Replica Compressed journal
<=30 days retention
H O S T
V R A
V M
V M
P H Y S I C A L
S T O R A G E
V M
V M
V M
V M
I M M U T A B L E C O P Y
D R S I T E
V C E N T E R Z V M
P H Y S I C A L
S T O R A G E
H O S T
V R A
D A T A S T O R E S
Replica Compressed journal
<=30 days retention
H O S T
V R A
P H Y S I C A L
S T O R A G E
P R O D U C T I O N
V C E N T E R Z V M
P H Y S I C A L
S T O R A G E
H O S T
V R A
V M
V M
D A T A S T O R E S
Replica Compressed journal
<=30 days retention
H O S T
V R A
V M
V M
P H Y S I C A L
S T O R A G E
I M M U T A B L E C O P Y
D R S I T E
V C E N T E R Z V M
P H Y S I C A L
S T O R A G E
H O S T
V R A
D A T A S T O R E S
Replica Compressed journal
<=30 days retention
H O S T
V R A
P H Y S I C A L
S T O R A G E
V M V M V M V M
Scenario #1
Recovery
• Utilizes Live Failover
• Fully automated and orchestrated
• RPO of Seconds
• RTO of Minutes
• Only 3 clicks to failover
• Simple reverse replication and failback
Scenario 2
Prod and DR infrastructure is impacted
P R O D U C T I O N
V C E N T E R Z V M
P H Y S I C A L
S T O R A G E
H O S T
V R A
V M
V M
D A T A S T O R E S
Replica Compressed journal
<=30 days retention
H O S T
V R A
V M
V M
P H Y S I C A L
S T O R A G E
V M
V M
V M
V M
I M M U T A B L E C O P Y
D R S I T E
V C E N T E R Z V M
V R A
V R A
I A A S
P U B L I C C L O U D D R S I T E
Z C A
S T O R A G E
C L O U D
S T O R A G E
A P I
P R O D U C T I O N
V C E N T E R Z V M
P H Y S I C A L
S T O R A G E
H O S T
V R A
V M
V M
D A T A S T O R E S
Replica Compressed journal
<=30 days retention
H O S T
V R A
V M
V M
P H Y S I C A L
S T O R A G E
I M M U T A B L E C O P Y
D R S I T E
V C E N T E R Z V M
V R A
V R A
I A A S
P U B L I C C L O U D D R S I T E
Z C A
S T O R A G E
C L O U D
S T O R A G E
A P I
V M V M
V M V M
V M
Scenario #2
Recovery
• Utilizes Live Failover
• Fully automated and orchestrated
• Converts into public cloud IaaS on the fly
• RPO of Seconds
• RTO of Minutes
• Only 3 clicks to failover
• Simple reverse replication and failback
Scenario 3
All Hope is lost
P R O D U C T I O N
V C E N T E R Z V M
P H Y S I C A L
S T O R A G E
H O S T
V R A
V M
V M
D A T A S T O R E S
Replica Compressed journal
<=30 days retention
H O S T
V R A
V M
V M
P H Y S I C A L
S T O R A G E
V M
V M
V M
V M
I M M U T A B L E C O P Y
D R S I T E
V C E N T E R Z V M
V R A
V R A
I A A S
P U B L I C C L O U D D R S I T E
Z C A
S T O R A G E
C L O U D
S T O R A G E
A P I
P R O D U C T I O N
V C E N T E R Z V M
P H Y S I C A L
S T O R A G E
H O S T
V R A
V M
V M
D A T A S T O R E S
Replica Compressed journal
<=30 days retention
H O S T
V R A
V M
V M
P H Y S I C A L
S T O R A G E
I M M U T A B L E C O P Y
D R S I T E
V C E N T E R Z V M
V R A
V R A
I A A S
P U B L I C C L O U D D R S I T E
Z C A
S T O R A G E
C L O U D
S T O R A G E
A P I
I M M U T A B L E C O P Y
R E C O V E R Y
S I T E
V C E N T E R Z V M
P H Y S I C A L
S T O R A G E
H O S T
D A T A S T O R E S
H O S T
V R A V R A
P H Y S I C A L
S T O R A G E
V M V M
V M V M
Scenario #3
Recovery
• Utilizes immutable copy restores
• Repository is portable so can be
attached to any Zerto infrastructure
• Restores are still app-centric
• Available on prem and in cloud storage
• RPO and RTO longer that CDP restores
but no longer than traditional backup
#digitnorth
Ben Cooper
Energy, Commodities & Utilities Lead,
BJSS
Chris May
Architecture Capability Lead,
BJSS
BREAKOUT
C
BJSS Limited
May 2022
Helping to transform Elexon's central infrastructure and internal
systems to facilitate MHHS within Great Britain’s electricity market
DATA AND DECARBONISATION
THE SPEAKERS
Ben Cooper
Industry Lead – Energy, Commodities & Utilities
BJSS
Chris May
Architecture Capability Lead
BJSS
THE LEADING
TECHNOLOGY &
ENGINEERING
CONSULTANCY
Trusted by our 100 active clients, we
collaborate to deliver complex,
innovative technology, engineering
and industry solutions that millions of
people use every day.
Talented people working together
on complex projects.
Nine tightly-integrated
services, all underpinned
by Digital Transformation:
Locations across the UK, USA,
Europe and Australia.
Active engagements within
large enterprises.
Technology
& Engineering
Cloud
& Platform
Managed
Service
Data & AI
Strategy Design
Energy, Commodities
& Utilities
Financial
Services
Health &
Social Care
Retail &
Consumer Markets
Public Sector
Betting &
Gaming
Transport
LowCode Sustainability
Cyber Security
Delivery by:
OUR LOCATIONS
> Copenhagen
> Dublin
> Lisbon
> Porto
Europe
> Melbourne
Australia
> Aberdeen
> Birmingham
> Bristol
> Cardiff
> Edinburgh
> Exeter
> Glasgow
> Leeds
> Lincoln
> Liverpool
> London
> Manchester
> Milton Keynes
UK
> Newcastle
> Nottingham
> Reading
> Sheffield
> Swansea
> York
> Houston
> New York
USA
WHO ARE ELEXON?
Elexon is responsible electricity settlement which is essential to the smooth
running of the electricity system in GB
> Elexon manages the Balancing and Settlement Code (BSC) for Great Britain’s electricity market
> In simple terms, they compare the amount of electricity that generators say they will produce, and how much
electricity suppliers say will be consumed.
> They then work out the prices for these differences, and transfer funds between the relevant parties.
Key Stats:
> Elexon handles more than 1.5m meter readings each day
> Elexon settles around 46 TWh of electricity annually
> Elexon handles billions of pounds of electricity companies’ money each year.
SO WHAT IS MHHS?
The Market-wide Half Hourly Settlement (MHHS) Programme is an industry first, in that Ofgem
has placed responsibility on the industry to deliver the Programme and made Elexon the Senior
Responsible Owner (SRO) of the Programme.
> The outcome of MHHS will be a faster, more accurate settlement process for all market participants
> MHHS will see the introduction of site-specific reconciliation using half-hourly meter readings
> MHHS is a key enabler to a smarter, more flexible energy system and will be vital in supporting flexible solutions to
enable the nation’s transition to Net Zero
> MHHS is expected to save consumers up to £4.5B over the next 20 years
> The first step in defining the ‘blueprint’ for future large change programmes within the energy industry.
WHAT IS BJSS’ ROLE?
BJSS are proud to support Elexon’s Helix programme, a multi-year programme which is
the largest transformation of Elexon’s central systems and infrastructure for more than twenty
years.
> Helix is delivering the changes to Elexon’s internal systems and processes in support of MHHS
> BJSS are responsible for delivering WP1 – the Data Hub, as well as supporting overall programme leadership to support
the enterprise agile delivery
> Multi-supplier programme, working alongside CGI and Cognizant
> Working closely with Microsoft throughout the delivery, leveraging our Microsoft Gold Partner status to ensure best
practice and maximise the value of Azure cloud technologies to support the programme
> The data hub is crucial to the success of Helix as it underpins the other components of the programme, managing the
data that other aspects of the service require, in order to accurately calculate balancing costs and provide settlement
process back to suppliers.
Meter
Contract
Balance
Costs
ISD
Settlement
Costs
WHAT ARE WE BUILDING?
Price
Load Shape Allocate
> 30 million updates
(1.5 billion rows) per day
> 10 TB working set
CHALLENGES
Large scale IOT-
style data
Long ramp-up
period
Complex and
evolving
interfaces
Security
> Scalable cost model
over next 5-10 years
> MHHS program in-flight
> Legacy data flows
> Large volume of PII
> Maybe in the future?
PROBLEMS WE DON’T HAVE
Exploratory
data science
Un-predictable
scale
Data sprawl Poor data quality
> We’re bound by the
number of houses in the
UK
> We have a small, well
understood set of data
types
> Most of the data we
receive has been
pre-validated by
upstream systems
TECHNOLOGY CHOICE PRINCIPLES
Azure
Favour PAAS
or SAAS over
IAS
Separate MHHS
components
should be
separate
systems
A WORD ON “BIG DATA” PROCESSING
Proprietary runtimes for open tools
Spark
(processing)
Parquet /
Delta / Avro
(storage)
AZURE DATA PROCESSING
> Many, many products available!
> Lots of different ways to solve the same problem
> Assuming your data is big and parallelisable
> Storage: ADLS, Parquet, Avro, Delta
> Ingest: DataFactory (Integration), EventHubs (Streaming)
> Processing: Spark
> DataBricks or Synapse or Stream Analytics or DF Spark or…
> POC a few, pick one. You can change later if you need to…
Upstream
MHHS
Downstream
MHHS
Legacy
WHERE NEXT?
Helix
> Complete development work
> Wait for the rest of MHHS to catch up
> Industry testing (12 months)
> Other data-intensive applications within Elexon
> Data Governance requirements
Re-use the data platform capability
THANKS FOR YOUR TIME
Visit our
stand for a
chat
Connect
with us
#digitnorth
Raymond Setchfield
Head of Technical Services,
DataVita
Richard Woodfield
Director,
RDB Concepts
BREAKOUT
D
PROBLEMATIC
WORKLOADS
Focus on Oracle
• Problem definition
• Workload Locations and Types
• Distributed workload support challenges
• Problem Workloads
• Use cases 1-3:
• Problem - analysis - solutions
Agenda
Focus on
the workload
DataVita
Services
On-Prem/DC
SELF HOSTED APPS
New POS SaaS
API
New Other SaaS
API
Data Warehouse
Public or Private
Cloud
Normal Stuff
Databases
Sysadmin
Patches
Updates
Networks
Break Fix
New Stuff
Database appliances
Hyperscaler Admin
Hyperscaler workload costs
APIs
Complex ETL
Multiple End Points
Containers
DevOps
BI Work Loads
Public Cloud
Hybrid Clouds
Key challenge then is:
• Transform to modern workloads
• Maintain stability
Most organisations will need help with this.
• Legacy OS
• Legacy Application Stack
• Complicated Architecture
• Licensing issues
• Cross platform Workflows and ETL
What
about the
problem
workloads?
The ideal support partner provides:
• Connected infrastructure options
across public, private, on-prem
and SaaS
• Can provide a Full Stack service
across those platforms
• Has a single point of contact for
resolution across all platforms for:
• Security, network, application
and database level
For modern workloads and legacy
applications.
• Strategic move to Azure tenancy
frustrated by core application vendor
• API issues with Core Apps to SaaS
providers
• Oracle licence issues
Use Case 1.
(Small Bank)
Solution:
Oracle friendly HA cloud, with cross
platform monitoring and support
• Ancient stack and Infrastructure - end
of life
• Needed custom patching to bring
stack up to current support levels
• Move from traditional metal
infrastructure to streamlined HA
Database Optimised Cloud
Use Case 2.
(Large Website)
Solution:
Custom patching regime to new OS/Stack
versions
HA Database friendly cloud with full-resolving
support.
Business disruption caused change in
business needs - move to multi-franchise
model
Multiple POS systems introduced
Move from IBM/Oracle to Legacy Cloud
environment
Flexible compute - near SaaS support and
cross platform monitoring and workflow
management
Use Case 3.
(High Street Restauranteur)
Solution:
Oracle friendly HA cloud, with cross
platform monitoring and support
Problematic Workloads
With a focus on Oracle

DIGIT North 2022

  • 1.
    Thursday 19th May2022 | P&J Live Aberdeen, UK #digitnorth
  • 2.
  • 3.
    James McLean CIO– SSEN Transmission A Five Year Transformation….
  • 4.
    Overview ➢ Who areSSEN Transmission? ➢ What we started with, where we are, and where we are going ➢ Organisation and Operating model - Moving to Value Stream delivery models ➢ Hiring and outsourcing ➢ Culture alignment and executive support for the strategy
  • 5.
    • Transmission takesenergy from Generators and hands it off to Distribution companies – WE ARE THE MOTORWAYS. • It is a price control business funded by Ofgem currently in RIIO-T2 which ends April 2026 • Fastest growing Transmission company driven by ScotWind & NOA network expansion • To meet Network energy targets we will need to capital invest significantly, every year until to 2030 Network Option Assessment (NOA) on Vimeo 10Gw 24Gw ScotWind Leasing Plans
  • 6.
    What we startedwith, where we are, and where we are going Build and Fly at the same time What we started with 2019/20: • Low core system digitisation; many spreadsheets; huge green field • Digital transformation plan submission to Ofgem and circa £45m awarded • Team of 12 • Cloud first strategy – price control is a timebox • Ramp up and establish pace of programmes and organisation build out Where we are: • Team of 30 established – Project delivery, Service Delivery, Analytics, Data Governance, Operations Technology, Architecture • Core systems re-platformed to cloud, separated from legacy support • Value streams established, culture of digitisation underway • Service Delivery function and Technical support teams growing • Improving and developing departmental controls, standards, procedures, policy adherence Where are we going 24/25: • Estimated team of 45 – fully staffed to current org design • Substantial progress of digital programme – agile exploitation on core platforms • Further strategic plans necessary to support business growth • Submittal of RIIO-T3 Digital business case • April 2026 new price control begins
  • 7.
    Change Resources Change Resources Change Resources Change Resources Change Resources VS1: Stakeholders & Customers VS2:Capital Projects VS3: Planning & Commercial VS4: Operations IT VS5: Functions, Integration, Exploitation Product Owner 3rd Party Vendors Solution Architect Security Architect Security Assurance Delivery Lead Business Analyst Change Resources Data & Analytics Product Owner Delivery Lead Business Analyst Change Resources Data & Analytics Product Owner Delivery Lead Business Analyst Change Resources Data & Analytics Product Owner Delivery Lead Business Analyst Change Resources Data & Analytics Product Owner Delivery Lead Business Analyst Change Resources Data & Analytics Solution Architect Cyber Program CIO Head of Cyber Resilience OT CROT Project (Waterfall) Solution Architect Security Assurance 3rd Party Vendors Digital Program Manager Head of IT Operations Head of Data & Analytics Lead Solution Architect Transmission Operating Model Internal provider of services – with flex to use external suppliers e.g. fixed capacity resources Hybrid Waterfall with Agile, shifting to primarily Agile as culture evolves Lead Security Assurance Directorates
  • 8.
    Hiring and Outsourcing Clearuse cases and differentiation Staffing Strategy: • Differentiating service roles • Roles where deep business understanding creates value • Challenging market conditions Outsource Strategy: • Leverage Group provision • SaaS, PaaS Cloud provision for key systems • SSE Cloud for Integrated Data Platform Vendor Strategy: • Accelerate insight and delivery from expertise • Long term partnerships with framework suppliers • Leverage Agile experience and establish MVP’s
  • 9.
    Culture Alignment toachieve Digital Transformation To be successful and realise the value and business outcomes set out in the Digital Vision, the following needs to be in-place The Executive Committee must believe in the Digital Vision and Strategy. Leadership commitment To deliver at pace we will have the right governance but that the programme requires fiscal flexibility to adapt to circumstance as we evolve our capability. Target setting and governance Our digital journey is heavily depend on developing the skills and capabilities required to ensure that the organisation can absorb and embrace the digital change. Organisational readiness and communication Ensure the right people come together from business and IT to deliver each initiative, dedicating the right amount of time to deliver the outcomes Implement, accelerate & scale - “Start small, think big, act fast” Digital should become embedded in our ways of working and business as usual to ensure that we are flexible to change at all levels. Sustain We need to encourage the awareness of the intrinsic value of data as an asset to the business and stewardship of that data. Fostering a digital & data culture Recognition that the digital investment benefits will be realised not only during T2 but into T3 and beyond; this is a long game. Business value focused
  • 10.
    Value of Digitalwithin SSEN Transmission Digital Transformation is key to the delivery of SSEN Transmission’s commitments in the RIIO-T2 5 year plan, as well as meeting the broader digital ambitions of SSE Group Ofgem: “The fastest route to Net Zero is via Data and Digitalisation” Optimise Operations Reduced manual processing, multiple data entry and information retrieval. Enhanced Customer Experience Deliver the great stakeholder and customer experience needed to meet increased expectations, and in-line with our peers Attract & retain talent Support the growing workforce with the digital and data skills they need in the modern world, and providing the capabilities they need to deliver our strategic objectives and meet their personal goals Increase safety Through better visibility of our operations and our people Readiness for T3 Be better prepared with the right platforms and processes to react to the challenges & opportunities that T3 will bring Simplify & Standardise Deliver the capabilities that the business desire, consolidate existing tools where needed and developing the platforms to collaborate effectively with Suppliers to maximise the value they deliver to SSENT Improve decision making (more informed and quicker) Better, faster, fact-based decision making at all levels through self- service reporting & analytics. Reduce Network Risk Better data and information to inform NARM and asset performance to inform and optimize investment decisions
  • 11.
    Thank you forlistening! 11
  • 12.
    #digitnorth Steve Roud Chief Officer:Digital & Technology, Aberdeen City Council Sandie Scott People Development Manager, Aberdeen City Council
  • 13.
    Digital (R)evolution: Developing anOpen Business Platform for Multi-Agency Working
  • 14.
    Digital (R)evolution: Developing anOpen Business Platform for Multi-Agency Working Chief Officer of Digital & Technology Steve Roud People Development Manager Sandie Scott ▪ Setting the vision ▪ From vision to reality ▪ Blending evolution and revolution to achieve pace and stability ▪ Adoption and change management
  • 15.
    The Nature of Work The Workforce ofthe Future The Workplace of the Future What are the new and evolving needs of the city and citizens? How does this change the work we do? Where will our employees interact with customers? Where and how can our employees do their best work? What skills and behaviours will our people need to thrive? How might our culture need to shift? Aberdeen City Transformation
  • 16.
    Multi-Agency Transformation & LOIP Improvement ACC Transformation Programme Whole System Change Service Design (Annual Critical Path) TheNature of Work The Workforce of the Future The Workplace of the Future Aberdeen City Transformation
  • 17.
    The Nature of Work The Workforce ofthe Future The Workplace of the Future Multi-Agency Transformation & LOIP Improvement ACC Transformation Programme Whole System Change Service Design (Annual Critical Path) Aberdeen City Council Business Platform
  • 18.
    The Nature of Work The Workforce ofthe Future The Workplace of the Future Multi-Agency Transformation & LOIP Improvement ACC Transformation Programme Whole System Change Service Design (Annual Critical Path) Underlying Platform Components (Customer)
  • 19.
    The Nature of Work The Workforce ofthe Future The Workplace of the Future Multi-Agency Transformation & LOIP Improvement ACC Transformation Programme Whole System Change Service Design (Annual Critical Path) Underlying Platform Components (Data)
  • 20.
    The Nature of Work The Workforce ofthe Future The Workplace of the Future Multi-Agency Transformation & LOIP Improvement ACC Transformation Programme Whole System Change Service Design (Annual Critical Path) Underlying Platform Components (ACC apps)
  • 21.
    The Nature of Work The Workforce ofthe Future The Workplace of the Future Multi-Agency Transformation & LOIP Improvement ACC Transformation Programme Whole System Change Service Design (Annual Critical Path) Aberdeen City Council Transformation
  • 22.
    Internal Drivers andEnablers Digital Principles Main Drivers for change Customer/ Data/ Digital Strategy Technology change opp End of life/ burning platforms Business change opps Regulatory change Commercial challenges Cost Trajectory • Reduce costs • Visibility and control of cost base • Simplification and standardisation • Rationalise licencing Technology Trajectory • Removal of components/ systems • Simplify support • Drive controlled self service Target Architecture
  • 23.
    Driving Innovation Convergence App migration Appmodernisation Foundational Strategic Value and Capabilities Application Dev Data Estate Smart Apps (Infused with pre-built AI) Intelligent Apps (Cloud Native) Data migration Data modernisation Advanced Analytics Data Intelligence (AI/ML)
  • 24.
  • 26.
    How it started… Inpartnership with 2019
  • 27.
    How it’s going…. Successfullymigrated data to the cloud Teams sites established for every single Cluster and Service in the Council An army of Digital Champions leading the way An elite crack squad of Super Champs training their peers Programme for Senior Managers Teams, SharePoint, Yammer and Stream fully established.
  • 28.
    Moving towards aMulti-Agency approach Invited partners to join our Super Champion community Duplicated successful structure over to ACHSCP Open approach to resource and knowledge sharing Presenting to the Digital Office Request-a-Guest
  • 29.
    HOW WE DIDIT Training Voice Co-creation Communications Empowering Managers Executive Sponsorship Self-managing People feel knowledgeable, capable and confident to transition to the future state People share their views and ideas through established reliable channels, digital and face-to-face. People are collectively designing solutions to organization wide issues or challenges set by leadership Communicate the business reasons of the change and how the change will impact employees Engage managers and supervisors toguide employees through changes, reinforce and role model behaviours at a locallevel. Create active and visible executive engagement People make change happen. Spontaneous self-led groups with minimal intervention corporately. Measurement Measuring if our changes are having the desired impact towards solving problems and achieving our business objectives
  • 30.
  • 32.
    Top things thatmade a difference 1. Clear direction and tasks 2. Recruitment 3. Sponsorship and support 4. Reward and recognition 5. Visibility and clarity
  • 33.
    Digital (R)evolution: Developing anOpen Business Platform for Multi-Agency Working Chief Officer of Digital & Technology Steve Roud People Development Manager Sandie Scott
  • 34.
    #digitnorth Tanya Knowles Head ofDigital Services, North Sea Transition Authority
  • 35.
    Welcome Driving innovation throughinfrastructure reporting Tanya Knowles, Head of Digital Services © OGA 2022 This presentation is for illustrative purposes only. The OGA makes no representations or warranties, express or implied, regarding the quality, completeness or accuracy of the information contained herein. All and any such responsibility and liability is expressly disclaimed. The OGA does not provide endorsements or investment recommendations. Oil and Gas Authority is a limited company registered in England and Wales with registered number 09666504 and VAT registered number 249433979. Our registered office is at 21 Bloomsbury Street, London, United Kingdom, WC1B 3HF
  • 36.
    NSTA’s role Creating valuethrough strategic approach and focused action Strategic Vision Digital Strategies Early Action Open data, NDR, website & access to data Early Outcomes Improved compliance, benchmarking & data quality Powers Energy Act 2016 Petroleum Act 1998
  • 37.
    Insights Benchmarking and opendata to encourage positive action Digital Energy Platform • Public access • Downloadable data • Cloud based • Integrated with other data sources • Authoritative Geographic Information Systems (GIS) Energy transition & integration Power of data and digital Digital excellence unlocking numerous insights and opportunities Exploration Hydrocarbons & CCS Transparency Energy Pathfinder Inclusion
  • 38.
    Why did wedo it? Background • Original purpose of data • Original process for collection Potential uses • Decommissioning, repurposing • Different attributes required • Data quality paramount Using technology • Spatial formats • Attribute and spatial-based quality checks
  • 39.
  • 40.
    Practical implementation ofdata quality improvement • Numerous improvements including requiring spatial formats to be reported • Enforcing data quality by automated checks sending out automated emails • Working with companies to help them report data correctly • Positive feedback Infrastructure reporting Scope 110 Companies responding 40+ companies reporting data 36 basic automated checks 45 Types of infrastructure 2 workshops 40+ resubmissions
  • 41.
    Future plans More attributesDriving further quality improvements Industry involvement Tighter definitions More checks Submissions more automated
  • 42.
  • 43.
  • 44.
    © 2022 NasuniCorporation - Confidential The Sanctity of Data MALCOLM BROWN, ENERGY SUBJECT MATTER EXPERT, NASUNI
  • 45.
    45 | ©2022 Nasuni Corporation - Confidential New Expectations & Demands on IT File Infrastructure Seismic Data High Res Video 3D Modelling Merger & Acquisition Exploding File Data UNINTERRUPTED BUSINESS CONTINUITY Global Resources Global Access
  • 46.
    46 | ©2022 Nasuni Corporation - Confidential Exabytes Hyperscale Datasets Future Terabytes 10 Years Ago Petabytes Today Gigabytes 20 Years Ago
  • 47.
    47 | ©2022 Nasuni Corporation - Confidential A Typical Environment
  • 48.
    48 | ©2022 Nasuni Corporation - Confidential Legacy File Storage Environment OFFSITE BACKUP Admin Console DISASTER RECOVERY SITE MPLS/WAN REMOTE OFFICE REMOTE OFFICE REMOTE OFFICE Admin Admin Admin Admin Admin Admin MPLS/WAN MPLS/WAN HQ DATA CENTER Admin Console Admin Console Admin Console Admin Console FILE SERVERS & NAS SILOS FILE BACKUP SOFTWARE & HARDWARE Cost & Complexity • Capacity Growth • Data Silos • Backups • Mgmt Overhead ? ? Multi-Site File Sharing • File Sync • Access Anywhere Ransomware • Disaster Recovery ?
  • 49.
    49 | ©2022 Nasuni Corporation - Confidential The Shortest Path Possible 5 Mbps 2 Mbps VDI VDI
  • 50.
    50 | ©2022 Nasuni Corporation - Confidential Create a Golden Master of all data from day 1 using Immutable Objects Immutable Snapshots Protected Encrypted Continuous Versions Indestructible
  • 51.
    51 | ©2022 Nasuni Corporation - Confidential File Data Platform Approach BACKUP/FAST RECOVERY PRIMARY FILE STORAGE DISASTER RECOVERY FILE SYNC CAPABILITIES SINGLE MANAGEMENT CONSOLE GLOBAL FILE SYSTEM IN OBJECT STORAGE CLOUD ORCHESTRATION APP& SAAS INTEGRATIONS DIFFERENTIATORS EDGE CACHING
  • 52.
    52 | ©2022 Nasuni Corporation - Confidential Unstructured Data is Vulnerable
  • 53.
    53 | ©2022 Nasuni Corporation - Confidential Multi-Layered Security Strategy
  • 54.
    54 | ©2022 Nasuni Corporation - Confidential Continuous File Versioning Reduces Recovery Times Disaster Event Recovery Point Objective (RPO) Recovery Time Objective (RTO) Seconds Lost Data Time to Resume Minutes Hours Days Weeks Seconds Minutes Hours Weeks Synchronous CDP Tape Backups Offsite Tape Local Tape Synchronous CDP Traditional Modern/Cloud Snapshots Snapshots DR Failover
  • 55.
    55 | ©2022 Nasuni Corporation - Confidential - means putting data first and acknowledging that if something fatally happens to your company’s intellectual property housed within years of file data, you're putting your entire organization at risk. "The Sanctity of Data"
  • 56.
    56 | ©2022 Nasuni Corporation - Confidential - means putting data first and acknowledging that if something fatally happens to your company’s intellectual property housed within years of file data, you're putting your entire organization at risk. So, what do we do as IT leaders? "The Sanctity of Data"
  • 57.
    #digitnorth Rotimi Alabi Founder &CEO, RAB-Microfluidics BREAKOUT A
  • 58.
    Copyright RAB-Microfluidics 2022 Version1.0. Confidentiality Statement: This document is the property of RAB-Microfluidics R&D Company Limited and is considered to be strictly confidential. It contains information intended only for the person to whom it is transmitted. Improving Machine Reliability with Data-Driven Insight enabled by Automation Delivered By Dr Rotimi Alabi
  • 59.
  • 60.
    Copyright RAB-Microfluidics 2022 60 TheProblem 60 Lubrication related engine failure Limitations on technologies Costs
  • 61.
    Copyright RAB-Microfluidics 2022 61 Howwe are addressing the problem 61
  • 62.
    Copyright RAB-Microfluidics 2022 IndustryChallenge and Market Opportunity £2.1 Bn spent on breakdown and downtime losses. 2.06bn spent on breakdown and Downtime loses £2.83 Bn spent to diagnose failure. Market Growth CAGR – 8.7% Analysis automation will add £400 Mn to testing and analysis market by 2025 – Markets and Markets 2020 62 Total Market Value - £5.2 Bn 1044 lubrication related engine failures in the maritime industry in 2020.
  • 63.
  • 64.
    Copyright RAB-Microfluidics 2022 TheTechnology H-Cell Selective Extraction Laminar Flow Fluidic interface Hexane Outlet Sample Outlet Oil Hexane Hexane Oil Hexane 300 𝜇m
  • 65.
    Copyright RAB-Microfluidics 2022 Comparisonwith Standard Methods Using three oil components :- • Acid Number • Base Number • Insoluble Content
  • 66.
    Copyright RAB-Microfluidics 2022 0 1 2 3 4 5 6 01 2 3 4 5 6 Microfluidics Method (mgKOH/g) ASTM D664 (mgKOH/g) 1:1 Gradient Fit 95% Confidence Interval Comparison with Standard Methods: Acid Number
  • 67.
    Copyright RAB-Microfluidics 2022 0 10 20 30 40 50 60 70 80 90 010 20 30 40 50 60 70 80 90 95% Confidence Interval 1:1 Gradient Fit IP 276 (mgKOH/g) Comparison with Standard Methods: Base Number Microfluidics Method (mgKOH/g)
  • 68.
    Copyright RAB-Microfluidics 2022 0 0.2 0.4 0.6 0.8 1 1.2 1.4 00.2 0.4 0.6 0.8 1 1.2 1.4 ASTM D893 (%) 1:1 Gradient Fit 95% Confidence Interval Comparison with Standard Methods: Insolubles Microfluidics Method (mgKOH/g)
  • 69.
    Copyright RAB-Microfluidics 2022 69 PortableDevice Machine Integrated Device Product Versions
  • 70.
  • 71.
    Copyright RAB-Microfluidics 2022 12 3 4 5 6 7 8 9 10 11 12 13 14 15 16 17 18 19 20 0.0 1.0 2.0 3.0 4.0 5.0 1 2 3 4 5 6 7 8 9 10 11 12 13 14 15 16 17 18 19 20 Hours Days H-Cell TAN (mgKOH/g) 1 2 3 4 5 6 7 8 9 10 11 12 0.0 1.0 2.0 3.0 4.0 5.0 1 2 3 4 5 6 7 8 9 10 11 12 Hours Days RHS: Starboard Engine LHS: Portside Engine Allowable Limit <3.5 mgKOH/g Allowable Limit <3.5 mgKOH/g Case Study: Marine Shipping Vessel
  • 72.
    Copyright RAB-Microfluidics 2022 create MicrofluidicLab-on-a-chip Technology Online Analysis/Big Data Generation Digital Analogue/Twin Predictive Analytics/Maintenance Value • Enhanced production efficiency. • Better understanding of machinery performance. • Automation and digitisation of oil analysis. • Machinery availability. • Cost savings. • Predictive analytics and maintenance. Value Proposition 72
  • 73.
    Copyright RAB-Microfluidics 2022 73 Summary •Platform technology that permits the real-time analysis of lubricating oil. • Address unmet need for rapid point-of- use multi-parameter testing of lubricant samples. • Transform lubricating oil analysis by: o automating conventional processes. o information for predictive analytics models and internet of things (IoT) modules.
  • 74.
    Copyright RAB-Microfluidics 2022 ContactUs. Monday – Friday 08:00 – 17:00 Business Hours rotimi.alabi@rab-microfluidics.co.uk E-mail Address Unit 5 Aberdeen Science & Technology Park Bridge of Don Aberdeen AB1 2AB Building Address 07429 315557 01224 010400 Telephone Number
  • 75.
    #digitnorth John Gonsalves Principal FieldEvangelist, Aviatrix BREAKOUT F
  • 76.
    © 2022,Aviatrix Allrights reserved. Secure Cloud Networking, Visibility, and Multi-Cloud Operations John Gonsalves Principal Evangelist
  • 77.
    © 2022,Aviatrix Allrights reserved.
  • 78.
    © 2022,Aviatrix Allrights reserved.
  • 79.
    © 2022,Aviatrix Allrights reserved. Over 500 Enterprise Customers 60 of the Global Fortune 500 60% in a Single Cloud Today 17,000 Aviatrix Certified Engineers (ACE)
  • 80.
    © 2022,Aviatrix Allrights reserved. “Organizations looking for advanced networking functionality missing from native public cloud providers and/or those that desire a consistent networking console across multiple public cloud providers, should shortlist Aviatrix” Cool Vendors in Cloud Networking April 16, 2021
  • 81.
    © 2022,Aviatrix Allrights reserved.
  • 82.
    © 2022,Aviatrix Allrights reserved. Secure Cloud Networking
  • 83.
    © 2022,Aviatrix Allrights reserved. Private Interconnect CLOUD 2 CLOUD 3 CLOUD 4
  • 84.
    © 2022,Aviatrix Allrights reserved. Private Interconnect CLOUD 2 CLOUD 3 CLOUD 4 Aviatrix Controller Programmatically Leverages and Controls Native Constructs 1 VPC VPC VCN VCN VPC VPC VNET VNET VPC VPC Available in AWS Marketplace
  • 85.
    © 2022,Aviatrix Allrights reserved. Aviatrix Controller CLOUD 2 CLOUD 3 CLOUD 4 VPC VPC VCN VCN VPC VPC VNET VNET VPC VPC Adds Advanced Networking and Security on Top In Each Cloud 2 Region 1 Region 2 Private Interconnect
  • 86.
    © 2022,Aviatrix Allrights reserved. Aviatrix Controller CLOUD 2 CLOUD 3 CLOUD 4 VPC VPC VCN VCN VPC VPC VNET VNET VPC VPC Region 1 Region 2 Private Interconnect Consistent Networking
  • 87.
    © 2022,Aviatrix Allrights reserved. Aviatrix Controller CLOUD 2 CLOUD 3 CLOUD 4 VPC VPC VCN VCN VPC VPC VNET VNET VPC VPC Region 1 Region 2 Private Interconnect Consistent Visibility and Troubleshooting
  • 88.
    © 2022,Aviatrix Allrights reserved. Aviatrix Controller CLOUD 2 CLOUD 3 CLOUD 4 VPC VPC VCN VCN VPC VPC VNET VNET VPC VPC Region 1 Region 2 Private Interconnect Consistent Security
  • 89.
    © 2022,Aviatrix Allrights reserved. Aviatrix Controller CLOUD 2 CLOUD 3 CLOUD 4 VPC VPC VCN VCN VPC VPC VNET VNET VPC VPC Region 1 Region 2 Private Interconnect Consistent Automation
  • 90.
    © 2022,Aviatrix Allrights reserved. Other “Multi-Cloud” Solutions
  • 91.
    © 2022,Aviatrix Allrights reserved. Security Embedded Into Your Cloud Network
  • 92.
    © 2022,Aviatrix Allrights reserved. Aviatrix Controller CLOUD 2 CLOUD 3 CLOUD 4 VPC VPC VCN VCN VPC VPC VNET VNET VPC VPC Private Interconnect Threat Database “Malicious IPs” ThreatIQ with ThreatGuard “All Seeing” Data Plane
  • 93.
    © 2022,Aviatrix Allrights reserved. Aviatrix Controller CLOUD 2 CLOUD 3 CLOUD 4 VPC VPC VCN VCN VPC VPC VNET VNET VPC VPC Threat Database “Malicious IPs” ThreatIQ with ThreatGuard Discovery and Notification Critical Threat Private Interconnect
  • 94.
    © 2022,Aviatrix Allrights reserved. Aviatrix Controller CLOUD 2 CLOUD 3 CLOUD 4 VPC VPC VCN VCN VPC VPC VNET VNET VPC VPC Threat Database “Malicious IPs” ThreatIQ with ThreatGuard Discovery and Notification Critical Threat Private Interconnect
  • 95.
    © 2022,Aviatrix Allrights reserved.
  • 96.
    © 2022,Aviatrix Allrights reserved. Network Behavior Analytics – Built Into Your Cloud Network Secure Cloud Networking Next Gen Firewalls Malicious IPs Known Threat Signatures Network Behavior Analytics Distributed Inspection Distributed Control New Capability of Aviatrix ThreatIQ™ - Fingerprints workload and traffic characteristics to form baseline - Custom for every environment - Identifies and alerts on abnormal network behavior - Not dependent on signatures or known threat database - Continuous baselining, ”learns” and improves over time Baseline (Normal) Current Behavior Anomaly detected; Alert Sent Example Behavior Analysis: Actionable Intelligence that may be an indicator of Data Exfiltration, Lateral Movement, New Ports/Protocols, DDoS attacks, Port scan detection, or unencrypted traffic flows
  • 97.
    © 2022,Aviatrix Allrights reserved.
  • 98.
    © 2022,Aviatrix Allrights reserved. TOPOLOGY REPLAY NETWORK GRAPH
  • 99.
    © 2022,Aviatrix Allrights reserved.
  • 100.
    © 2022,Aviatrix Allrights reserved.
  • 101.
    © 2022,Aviatrix Allrights reserved. Aviatrix Business Value Across Multiple Teams Increase Revenue Growth with Business Innovation • Drive higher revenue and margins from existing customers • Expand into new markets and quickly onboard new customers • Faster product time-to-market and revenue • Accelerate acquisition integrations Increase Control, Visibility, and Resource Efficiency • Faster monitoring and troubleshooting, lower MTTR • Automated provisioning using Terraform and APIs • Higher efficiency in network engineering and security teams Bridge the Talent Gap • Reduce recruiting and training expenses • Reallocate high-value resources to more strategic functions • Reduce operational costs by retiring legacy tech debt Reduce Business Risk • Identify and Remediate know threats automatically • End-to-End and high-performance encryption • Multi-cloud network segmentation • Consistent blacklisting / whitelisting filtering • Simplify network audit and compliance
  • 102.
    © 2022,Aviatrix Allrights reserved. Accelerate your cloud journey Aviatrix simplifies cloud networking, security and operational visibility to help customers meet enterprise requirements that solve real-world business challenges. Do more with less Reduce time to market Reduce the skills gap Reduce business risk Common control plane Distributed repeatable data plane Advanced network and security Day 2 operations and visibility Technical Benefits Business Benefits World-Class Support and Professional Service
  • 103.
  • 104.
    Driving Environmental Improvement withDigital Transformation and Space Data Sarah Middlemiss COO UK & Europe, Ecometrica
  • 105.
    Sustainability – niceto have, or business critical? In 2020, 95 Fortune 500 companies have a Chief Sustainability Officer Over 600 sustainability standards to report on
  • 106.
    Parallels with othersectors ESG Digital Finance
  • 107.
    What are wedoing? REPORT + COMPLY GHG Accounting Software
  • 108.
    What are doing? MONITOR Monitoringland based assets from space
  • 109.
    What are doing? LOOKAHEAD TCFD – Climate Risk Reporting
  • 110.
    Ecometrica Further Info &Contact Sarah Middlemiss COO Tel: +44 (0)131 662 4342 Mob: +44(0)7593 643 056 sarah.middlemiss@ecometrica.com
  • 111.
  • 112.
  • 113.
    Click to editMaster title text Click to edit Master subtitle text Insert Date What is a brand? www.tltechsmart.com
  • 114.
    Click to editMaster title text Click to edit Master subtitle text Insert Date Our Story www.tltechsmart.com
  • 115.
    Click to editMaster title text Click to edit Master subtitle text Insert Date Voice Trends - Control Ref. Statista Alexa Compatible Devices 2020+ ~4000 >100,000 2017 www.tltechsmart.com
  • 116.
    Click to editMaster title text Click to edit Master subtitle text Insert Date Voice Trends - Search www.tltechsmart.com
  • 117.
    Click to editMaster title text Click to edit Master subtitle text Insert Date Voice Trends - Commerce www.tltechsmart.com Ref. PWC Global Consumer Insights Pulse Survey
  • 118.
    Click to editMaster title text Click to edit Master subtitle text Insert Date Voice Trends - Commerce www.tltechsmart.com Ref. PWC Global Consumer Insights Pulse Survey
  • 119.
    Click to editMaster title text Click to edit Master subtitle text Insert Date Characteristics of a Voice Interface www.tltechsmart.com
  • 120.
    Click to editMaster title text Click to edit Master subtitle text Insert Date Benefits of a Voice-First Strategy www.tltechsmart.com
  • 121.
    Click to editMaster title text Click to edit Master subtitle text Insert Date Designing for Alexa Tutorials: ▪ Alexa Skills Kit ▪ Alexa Developers on YouTube ▪ Dabble Lab ▪ Codecademy Further community support: ▪ Github Alexa ▪ Alexa Presentation Language for creating display graphics – APL Ninja ▪ Alexa community Slack group TL Tech Voice strategy blog piece www.tltechsmart.com
  • 122.
    Click to editMaster title text Click to edit Master subtitle text Insert Date Thank You For further information: www.tltechsmart.com caroline@tltechsmart.com https://www.linkedin.com/in/caroline-laurenson/ https://www.createyourkindspace.com/
  • 123.
    #digitnorth Mark Stephen Journalist &Broadcaster, BBC Scotland Deryck Mitchelson Chief Information Security Officer, Check Point Mark Mitchell Technical Evangelist for the Office of the CTO, Check Point
  • 124.
    124 ©2022 Check PointSoftware Technologies Ltd. Deryck Mitchelson | Chief Information Security Officer Mark Mitchell | Technical Evangelist for the office of the CTO 19/05/2022 Ransomware, Recovery and Response
  • 125.
    125 ©2022 Check PointSoftware Technologies Ltd. • Ransomware • Recovery • Response Agenda
  • 126.
    126 ©2022 Check PointSoftware Technologies Ltd. 2021 Threat Landscape was exceptionally dangerous 2022 already looking CONSIDERABLY worse Ransomware APT SW vulnerabilities Supply chain *According to ThreatCloud Every month 10’s of millions of attacks 400K zero days* Nazar Naikon APT Nation state May Mar Microsoft Exchange Server Rampant Kitten Nation state Sep MDM Maze Apr Ryuk - HealthCare Oct Shopping month phishing Pay2Key Nov Qbot Aug Nation state Vicious Panda Mar Azure Cloud Jan HealthCare Jan TikTok Philips lightbulb Feb Covid-19 - first broad phishing campaigns Microsoft SigRed Jul Colonial Pipeline May Zoom GuLoader Jun Dec Sunburst / SolarWinds Nation state Following Microsoft Exchange Server Codecov Apr 2020 2021 APOMacro Sploit APT34 Feb Kaseya / REvil Jul JBS Jun Achilles
  • 127.
    127 ©2022 Check PointSoftware Technologies Ltd. The State of the Planet
  • 128.
    128 ©2022 Check PointSoftware Technologies Ltd. Ransomware
  • 129.
    129 ©2022 Check PointSoftware Technologies Ltd. Ransomware – The Ever Increasing Threat April 2022
  • 130.
    130 ©2022 Check PointSoftware Technologies Ltd. Average Ransomware Costs have doubled in 2021 National Security Threat Following the Colonial Pipeline attack The U.S. Department of Justice defined ransomware as a national threat, placing it at the same priority level as terrorism. Average downtime in 2021 following a ransomware attack is 10 days. By 2031, the cost of ransomware incidents could surpass $265 billion.
  • 131.
    131 ©2022 Check PointSoftware Technologies Ltd. Recovery • Discovery • People • Process
  • 132.
    132 ©2022 Check PointSoftware Technologies Ltd. Breaches are Inevitable? “… massive institutional beaches don’t need to happen as often as they do. Many occur not because of complex and sophisticated hacking, but because organisations have made basic and potentially avoidable mistakes in implementing their security schemes …” – Lily Newman, Wired.com, 2018
  • 133.
    133 ©2022 Check PointSoftware Technologies Ltd. Where They Fully Prepared? Are we TO COMPLACENT? Hacker group published 9GB of source code for 250 projects stolen from Microsoft including Bing, Cortana March ‘22 Hacker leaks 128GB of leaded files from Amazon streaming service Twitch October ‘21 Phishing email allowed hacker group to deliver ransomware payload shutting down all 526 shops. April ‘22 Hacker group published 190GB of confidential data including source code for boatloader of newer devices. Mar ‘22 Hacker group published 20GB of confidential data and 71,000 employee credentials Feb ‘22
  • 134.
    134 ©2022 Check PointSoftware Technologies Ltd. Response
  • 135.
    135 ©2022 Check PointSoftware Technologies Ltd. Cyber Hygiene Should be an Immediate Priority • Identify key services, products and assets • Develop and exercise incident response plan • Establish cyber awareness and education programme • Secure backups and regular restoration regime • Enforce least privilege and full auditing • Prioritise patch and change management, vulnerability scanning • Map cyber risks to business priorities and impact • End-to-end network security and monitoring • Multi-factor authentication enforcement
  • 136.
    136 ©2022 Check PointSoftware Technologies Ltd. Lessons Learnt from SEPA Ransomware Attack • Identify key services, products and assets • Develop and exercise incident response plan • Establish cyber awareness and education programme • Secure backups and regular restoration regime • Enforce least privilege and full auditing • Prioritise patch and change management, vulnerability scanning • Map cyber risks to business priorities and impact • End-to-end network security and monitoring • Multi-factor authentication enforcement Finding No 5 Finding No 26 -29 Finding No 17- 20 Finding No 34 - 35 Finding No 9 - 13 Finding No 14 - 16 Finding No 36 - 41 Finding No 25 - 29
  • 137.
    137 ©2022 Check PointSoftware Technologies Ltd. Lessons Learnt from SEPA Ransomware Attack
  • 138.
    138 ©2022 Check PointSoftware Technologies Ltd. Elevating Security Narrative to the Board Cyber Risks Technical Jargon Metric Reporting Policy and Compliance Reporting Investment Requests Skills Shortage Business Risks Executive Business Language Effectiveness and Efficiency Reporting Business Impact Enabling Business Priorities and ROI Automation Strategy and Succession Planning
  • 139.
    139 ©2022 Check PointSoftware Technologies Ltd. Consolidation Prevention Strategy Single Framework Unified Policy Asset Centric Shared Configuration Shared Intelligence Single Pane of Glass
  • 140.
    140 ©2022 Check PointSoftware Technologies Ltd. • Ransomware • Recovery • Response
  • 141.
    141 ©2022 Check PointSoftware Technologies Ltd. deryckm@checkpoint.com www.linkedin.com/in/deryckmitchelson/ markmi@checkpoint.com https://www.linkedin.com/in/mark-mitchell-5311119/
  • 142.
    #digitnorth Susan Krueger Senior ProjectManager: Health Informatics Centre, University of Dundee BREAKOUT B
  • 143.
    PICTURES Enabling large-scale medical imagedata research 19th May 2022 DIGIT North Innovation Summit Susan Krueger, PICTURES Project Manager skrueger001@dundee.ac.uk Project website: https://www.imageonamission.ac.uk/
  • 144.
    Overview PICTURES InterdisciPlInary Collaboration forefficienT and effective Use of clinical images in big health care RESearch (PICTURES) About Overcoming the challenges of providing access to population scale, routinely collected health and imaging data for AI development whilst protecting patient confidentiality Scope ▪ the Project ▪ the Problem ▪ the Solution
  • 145.
  • 146.
    PICTURES | theProject Context ▪ InterdisciPlInary Collaboration for efficienT and effective Use of clinical images in big health care RESearch (PICTURES) ▪ Medical Research Council (MRC) funded, 5-year programme of work ▪ Collaboration between the University of Dundee (UoD), University of Edinburgh (UoE), Abertay University, Public Health Scotland (PHS) and industry partner Aidence B.V. ▪ Effective start/end dates are 1st August 2019 to 31st July 2024
  • 147.
    PICTURES | theProject Motivation ▪ Linked, de-identified population level data ▪ Opportunity for very large-scale studies ▪ Wide range of disease areas ▪ Improved diagnostic accuracy ▪ New detection methods
  • 148.
    A TRE isa Trusted Research Environment. Also known as ‘Data Safe Havens’, TREs are highly secure computing environments that provide remote access to health data for approved researchers to use in research that can save and improve lives. What is a TRE? TREs help make research efficient, collaborative and cost effective, providing rich data that enables deep insights which will go on to improve healthcare and save lives. TREs provide approved researchers with a single location to access valuable datasets. The data and analytical tools are all in one place, a bit like a secure reference library. How is my data safeguarded? TREs make research safer. Making data available through a TRE means that people can be confident that their personal health data is accessed securely and their privacy protected. Learn more about TREs and discover examples of how TREs are being used to enable life-saving health research. Health data should always be kept safe and secure, and used responsibly to ensure privacy. Heath Data Research UK ensures these high standards are met by promoting the use of the ‘Five Safes’ model across all TREs. Learn more about TREs Why are they important? Safe People Only trained and specifically accredited researchers can access the data Safe Projects Data is only used for ethical, approved research with the potential for clear public benefit Safe Data Researchers only use data that have been de-identifed to protect privacy Safe Outputs All research outputs are checked to ensure they cannot be used to identify subjects Safe Settings Access to data is only possible using secure technology systems – the data never leaves the TRE
  • 149.
    PICTURES | theProject Core Programme ▪ increasing the capabilities of Safe Havens to support emerging technologies and new data types (images) ▪ building on existing measures, in place to maintain the trust of the public that their personal health data is used for the benefit of patients and / or the population as a whole ▪ 9 work packages: ▪ metadata for complex cohort building ▪ scalability and automation ▪ environments and tools for researchers ▪ speeding it all up
  • 150.
    PICTURES | theProject Exemplar 1 Developing a multivariable lung nodule malignancy risk prediction model for incidental lung nodules using both imaging markers and clinical data. Exemplar 2 Developing an algorithm to predict individual risk of dementia using MRI brain scans, genetic data and other longitudinal health records. Both exemplars will determine new information from routinely collected data that would otherwise have been ignored. Predicting and therefore treating diseases at an early stage improves patient outcomes and reduces the cost to the NHS. CT chest scans MRI brain scans
  • 151.
    PICTURES | theProject Data Science and Engineering Research Questions How to build research relevant Cohorts: Messy, unstructured, identifiable data! How to handle Big Data: scaling How can we protect patient data? Natural Language Processing Machine Learning and classification methods Hardware and Software optimisation methods: Next Generation Safe Haven Cybersecurity research
  • 152.
    PICTURES | theProblem Info model taken from https://dcm4che.atlassian.net/wiki/spaces/d2/pages/1835038/A+Very+Basic+DICOM+Introduction DICOM ▪ Digital Imaging and Communications in Medicine standard Radiologists communicate their findings to the referring clinician through text-based Radiology Reports (aka Structured Reports).
  • 153.
    PICTURES | theProblem PACS ▪ Picture Archiving and Communication System (PACS) ▪ Central archive ▪ Regional Health Boards ▪ Single PACS for Radiology ▪ Relatively stable population ▪ Unique healthcare identifier North Region East Region West Region
  • 154.
    PICTURES | theProblem Research Copy 2010-2018 Modality Total count of images Live CT 1,551,835,095 MR 475,172,769 PT 34,731,015 SR 27,539,556 CR 21,131,886 XA 7,746,882 RF 7,292,660 DX 6,274,075 MG 2,348,114 NM 1,222,818 PX 225,726 IO 100,608
  • 155.
    PICTURES | theProblem Pixel Data Images can contained burned in Personally Identifiable Information (PII)
  • 156.
    PICTURES | theProblem Table taken from https://towardsdatascience.com/understanding-dicom-bce665e62b72 DICOM Metadata Data elements or ‘tags’ in the Header contain values like name, ID, etc., and the image pixel data.
  • 157.
    PICTURES | theProblem Radiology reports are designed to be both machine and human readable, with information organised and hierarchical. Image taken from https://www.dicomstandard.org/docs/librariesprovider2/dicomdocuments/wp-cotent/uploads/2018/10/day2_s7_dicom_structured_reports_d-clunie.pdf?sfvrsn=d4e2b344_4 Structured Reports
  • 158.
    PICTURES | theProblem Handling Data at Scale https://www.researchgate.net/publication/239743213_Digital_imaging_in_radiology_practice_An_introduction_to_few_fundamental_concepts
  • 159.
    PICTURES | theSolution DE-IDENTIFY and PSEUDONYMISE PACS Researcher VM with tools to view and manipulate images Study-specific Image Metadata and Pixel Data (Project Ids) BUILD COHORT Research co-ordinators Cohort builders Researchers Disclosure Control Preamble Header Pixel Data DICOM DE-IDENTIFY and TRANSFORM IDENTIFIABLE ZONE DE-IDENTIFIED ZONE ANALYTIC ZONE System Administrators De-identification Analysts Scottish Medical Imaging (SMI) A microservices architecture For information on SmiServices go to https://github.com/SMI/SmiServices
  • 160.
    PICTURES | theSolution Complex Cohort Building Three methods of feature extraction 1. DICOM Tags 2. Natural Language Processing 3. Autoencoder Image taken from http://www.dclunie.com/pixelmed/DICOMSR.book.pdf Simple example of a DICOM Structured Report
  • 161.
    PICTURES | theSolution Complex Cohort Building Three methods of feature extraction 1. DICOM Tags 2. Natural Language Processing 3. Autoencoder Research Data Management Platform (RDMP) https://github.com/HicServices/RDMP/ Semantic Search System for Electronic Health Records (SemEHR) https://pubmed.ncbi.nlm.nih.gov/29361077/
  • 162.
    PICTURES | theSolution Protecting Patient Confidentiality Disclosure control – it’s all about the layers! • Legal • Procedural • Technical • Human GRAIMatter, a HDR UK funded sprint: • Aim: a range of tools and methods to support TREs to assess output from AI methods for potentially identifiable information, investigate the legal and ethical implications and controls, and produce a set of guidelines and recommendations to support all TREs with export controls of AI algorithms. GRAIMatter – a DARE UK Sprint project https://dareuk.org.uk/sprint-exemplar-project-graimatter/
  • 163.
    PICTURES Programme Scottish MedicalImaging (SMI) Service ▪ a national resource for the provision of images and associated report data to researchers ▪ may be linked to other available pseudonymised datasets ▪ launched in April 2022 ▪ small number of high impact research studies already underway ▪ aims to continually develop and grow in the coming years ▪ https://www.isdscotland.org/Products-and-Services/eDRIS/Scottish-Medical-Imaging-Service/
  • 164.
    Acknowledgments Acknowledgments ▪ Farr Instituteof Health Informatics Research and Dundee University Medical School. ▪ Medical Research Council (MRC) grant No. MR/M501633/1 (PI: Andrew Morris) and the Wellcome Trust grant No. WT086113 through the Scottish Health Informatics Programme (SHIP) (PI: Andrew Morris). ▪ MRC and EPSRC (grant No. MR/S010351/1) and the Chief Scientist Office of the Scottish Government Health and Social Care Directorates via a leverage grant made to Farr Scotland, and the Scottish Government through the “Imaging AI” grant award. ▪ This work was supported by Health Data Research UK, which receives its funding from HDR UK Ltd (HDR-5012) funded by the UK MRC, Engineering and Physical Sciences Research Council, Economic & Social Research Council, Department of Health and Social Care (England), Chief Scientist Office of the Scottish Government Health and Social Care Directorates, Health and Social Care Research & Development Division (Welsh Government), Public Health Agency (Northern Ireland), British Heart Foundation (BHF), & the Wellcome Trust. Further reading An extensible big data software architecture managing a research resource of real-world clinical radiology data linked to other health data from the whole Scottish population Nind T, Sutherland J, McAllister G, Hardy D, Hume A, MacLeod R, Caldwell J, Krueger S, Tramma L, Teviotdale R, Abdelatif M, Gillen K, Ward J, Scobbie D, Baillie I, Brooks A, Prodan B, Kerr W, Sloan-Murphy D, Herrera JFR, McManus D, Morris C, Sinclair C, Baxter R, Parsons M, Morris A, Jefferson E. Gigascience. 2020 Sep;9(10) . doi:10.1093/gigascience/giaa095. PMID: 32990744; PMCID: PMC7523405.
  • 165.
    Health Informatics Service Universityof Dundee Mail Box 15 Ninewells Hospital and Medical School Dundee DD1 9SY 01382 383102 dundee.ac.uk/hic hicservices-admin@dundee.ac.uk Thanks for Listening!
  • 166.
    #digitnorth Mike Caiger Senior SystemsEngineer, Zerto BREAKOUT E
  • 167.
    Ransomware Recovery withZerto Mike Caiger – Senior Systems Engineer at Zerto
  • 168.
    • Ransomware Challenges •Zerto architecture • Ransomware Recovery Scenarios Agenda
  • 169.
  • 170.
    Ransomware $265B estimated costof ransomware by 2031 Unplanned/Planned Disruptions 62.9% organizations have suffered a disruption Cloud Complexity By 2025, 100 zettabytes of cloud data Need 24x7: no downtime and no data loss TOP CUSTOMER CHALLENGES
  • 171.
    BEYOND THE COSTOF RECOVERY 21 days average disruption period of an attack 66% of victims suffered significant revenue loss 25% of victims suffered a period of business closure $1.85 million average cost of ransomware recovery
  • 172.
    It’s not amatter of if, but when.
  • 173.
    2 4 6 3 Continuous user/admin education Never thinkyour organization is impenetrable Test recovery plans to prove RTOs and RPOs Keep systems patched and antivirus updated 1 5 Harden data protection solutions Take advantage of 3rd party expertise BEST PRACTICES FOR PREVENTION AND PREPARATION
  • 174.
    Guide for CybersecurityEvent Recovery Data Protection Where Does Data Protection Come In? Identify Protect Detect Cyber Event Respond to Cyber Event Remediate Root Cause Tactical Recovery Phase Strategic Recovery Phase Figure 3-1: NIST SP 800-184 Guide for Cybersecurity Event Recovery Relationship with the NIST CSF
  • 175.
    Continuous Data Protection Resumein minutes to seconds before an attack Ransomware Recovery Foolproof recovery with fastest RTO and RPO Disaster Recovery Freedom to innovate across clouds Multi-Cloud Mobility CONTINUOUS PROTECTION Any App, Any Cloud, Any Threat
  • 176.
  • 177.
    ▸ No productionimpact ▸ No scheduling, snapshots, or agents ▸ Hardware, Storage & Cloud Agnostic ▸ Always-on, always protected NEAR-SYNCHRONOUS REPLICATION Storage of your choice Software-only, simple deployment Protect on-premises, to the cloud, or both simultaneously ▶︎ SIMPLICITY AT SCALE ▶︎ HYBRID AND MULTI-CLOUD ▶︎ CONTINUOUS DATA PROTECTION
  • 178.
    GRANULAR POINT-IN-TIME RECOVERY WITH THE ZERTOJOURNAL Legacy vs. Journal-based Recovery 10:00:00 backup Up to 24 hrs data loss 6:00:00 snapshot Up to 4 hrs data loss 9:59:55 Rewind within seconds 10:00:00 Disaster hits ▶︎ SIMPLICITY AT SCALE ▶︎ HYBRID AND MULTI-CLOUD ▶︎ CONTINUOUS DATA PROTECTION ▸ Recover in minutes to seconds before an attack or disruption ▸ Fastest RPOs and RTOs ▸ Neutralize ransomware threats
  • 179.
    Applications recovered asa single entity DB Server App. Server Web Server File Server 2:48:00 AM 2:48:05 AM 2:48:10 AM 2:48:15 AM 2:48:20 AM DB Server App. Server Web Server File Server DB Server App. Server Web Server File Server DB Server App. Server Web Server File Server DB Server App. Server Web Server File Server ▸ Write order fidelity across entire multi-VM application stack ▸ No staggered backup windows ▸ All copies kept in app-centric groups APP-CENTRIC RECOVERY ▶︎ SIMPLICITY AT SCALE ▶︎ HYBRID AND MULTI-CLOUD ▶︎ CONTINUOUS DATA PROTECTION
  • 180.
    Scenario 1 All VMsget encrypted
  • 181.
    P R OD U C T I O N V C E N T E R Z V M P H Y S I C A L S T O R A G E H O S T V R A V M V M D A T A S T O R E S Replica Compressed journal <=30 days retention H O S T V R A V M V M P H Y S I C A L S T O R A G E V M V M V M V M I M M U T A B L E C O P Y D R S I T E V C E N T E R Z V M P H Y S I C A L S T O R A G E H O S T V R A D A T A S T O R E S Replica Compressed journal <=30 days retention H O S T V R A P H Y S I C A L S T O R A G E
  • 182.
    P R OD U C T I O N V C E N T E R Z V M P H Y S I C A L S T O R A G E H O S T V R A V M V M D A T A S T O R E S Replica Compressed journal <=30 days retention H O S T V R A V M V M P H Y S I C A L S T O R A G E I M M U T A B L E C O P Y D R S I T E V C E N T E R Z V M P H Y S I C A L S T O R A G E H O S T V R A D A T A S T O R E S Replica Compressed journal <=30 days retention H O S T V R A P H Y S I C A L S T O R A G E V M V M V M V M
  • 183.
    Scenario #1 Recovery • UtilizesLive Failover • Fully automated and orchestrated • RPO of Seconds • RTO of Minutes • Only 3 clicks to failover • Simple reverse replication and failback
  • 184.
    Scenario 2 Prod andDR infrastructure is impacted
  • 185.
    P R OD U C T I O N V C E N T E R Z V M P H Y S I C A L S T O R A G E H O S T V R A V M V M D A T A S T O R E S Replica Compressed journal <=30 days retention H O S T V R A V M V M P H Y S I C A L S T O R A G E V M V M V M V M I M M U T A B L E C O P Y D R S I T E V C E N T E R Z V M V R A V R A I A A S P U B L I C C L O U D D R S I T E Z C A S T O R A G E C L O U D S T O R A G E A P I
  • 186.
    P R OD U C T I O N V C E N T E R Z V M P H Y S I C A L S T O R A G E H O S T V R A V M V M D A T A S T O R E S Replica Compressed journal <=30 days retention H O S T V R A V M V M P H Y S I C A L S T O R A G E I M M U T A B L E C O P Y D R S I T E V C E N T E R Z V M V R A V R A I A A S P U B L I C C L O U D D R S I T E Z C A S T O R A G E C L O U D S T O R A G E A P I V M V M V M V M V M
  • 187.
    Scenario #2 Recovery • UtilizesLive Failover • Fully automated and orchestrated • Converts into public cloud IaaS on the fly • RPO of Seconds • RTO of Minutes • Only 3 clicks to failover • Simple reverse replication and failback
  • 188.
  • 189.
    P R OD U C T I O N V C E N T E R Z V M P H Y S I C A L S T O R A G E H O S T V R A V M V M D A T A S T O R E S Replica Compressed journal <=30 days retention H O S T V R A V M V M P H Y S I C A L S T O R A G E V M V M V M V M I M M U T A B L E C O P Y D R S I T E V C E N T E R Z V M V R A V R A I A A S P U B L I C C L O U D D R S I T E Z C A S T O R A G E C L O U D S T O R A G E A P I
  • 190.
    P R OD U C T I O N V C E N T E R Z V M P H Y S I C A L S T O R A G E H O S T V R A V M V M D A T A S T O R E S Replica Compressed journal <=30 days retention H O S T V R A V M V M P H Y S I C A L S T O R A G E I M M U T A B L E C O P Y D R S I T E V C E N T E R Z V M V R A V R A I A A S P U B L I C C L O U D D R S I T E Z C A S T O R A G E C L O U D S T O R A G E A P I
  • 191.
    I M MU T A B L E C O P Y R E C O V E R Y S I T E V C E N T E R Z V M P H Y S I C A L S T O R A G E H O S T D A T A S T O R E S H O S T V R A V R A P H Y S I C A L S T O R A G E V M V M V M V M
  • 192.
    Scenario #3 Recovery • Utilizesimmutable copy restores • Repository is portable so can be attached to any Zerto infrastructure • Restores are still app-centric • Available on prem and in cloud storage • RPO and RTO longer that CDP restores but no longer than traditional backup
  • 193.
    #digitnorth Ben Cooper Energy, Commodities& Utilities Lead, BJSS Chris May Architecture Capability Lead, BJSS BREAKOUT C
  • 194.
    BJSS Limited May 2022 Helpingto transform Elexon's central infrastructure and internal systems to facilitate MHHS within Great Britain’s electricity market DATA AND DECARBONISATION
  • 195.
    THE SPEAKERS Ben Cooper IndustryLead – Energy, Commodities & Utilities BJSS Chris May Architecture Capability Lead BJSS
  • 196.
    THE LEADING TECHNOLOGY & ENGINEERING CONSULTANCY Trustedby our 100 active clients, we collaborate to deliver complex, innovative technology, engineering and industry solutions that millions of people use every day. Talented people working together on complex projects. Nine tightly-integrated services, all underpinned by Digital Transformation: Locations across the UK, USA, Europe and Australia. Active engagements within large enterprises. Technology & Engineering Cloud & Platform Managed Service Data & AI Strategy Design Energy, Commodities & Utilities Financial Services Health & Social Care Retail & Consumer Markets Public Sector Betting & Gaming Transport LowCode Sustainability Cyber Security Delivery by:
  • 197.
    OUR LOCATIONS > Copenhagen >Dublin > Lisbon > Porto Europe > Melbourne Australia > Aberdeen > Birmingham > Bristol > Cardiff > Edinburgh > Exeter > Glasgow > Leeds > Lincoln > Liverpool > London > Manchester > Milton Keynes UK > Newcastle > Nottingham > Reading > Sheffield > Swansea > York > Houston > New York USA
  • 198.
    WHO ARE ELEXON? Elexonis responsible electricity settlement which is essential to the smooth running of the electricity system in GB > Elexon manages the Balancing and Settlement Code (BSC) for Great Britain’s electricity market > In simple terms, they compare the amount of electricity that generators say they will produce, and how much electricity suppliers say will be consumed. > They then work out the prices for these differences, and transfer funds between the relevant parties. Key Stats: > Elexon handles more than 1.5m meter readings each day > Elexon settles around 46 TWh of electricity annually > Elexon handles billions of pounds of electricity companies’ money each year.
  • 199.
    SO WHAT ISMHHS? The Market-wide Half Hourly Settlement (MHHS) Programme is an industry first, in that Ofgem has placed responsibility on the industry to deliver the Programme and made Elexon the Senior Responsible Owner (SRO) of the Programme. > The outcome of MHHS will be a faster, more accurate settlement process for all market participants > MHHS will see the introduction of site-specific reconciliation using half-hourly meter readings > MHHS is a key enabler to a smarter, more flexible energy system and will be vital in supporting flexible solutions to enable the nation’s transition to Net Zero > MHHS is expected to save consumers up to £4.5B over the next 20 years > The first step in defining the ‘blueprint’ for future large change programmes within the energy industry.
  • 200.
    WHAT IS BJSS’ROLE? BJSS are proud to support Elexon’s Helix programme, a multi-year programme which is the largest transformation of Elexon’s central systems and infrastructure for more than twenty years. > Helix is delivering the changes to Elexon’s internal systems and processes in support of MHHS > BJSS are responsible for delivering WP1 – the Data Hub, as well as supporting overall programme leadership to support the enterprise agile delivery > Multi-supplier programme, working alongside CGI and Cognizant > Working closely with Microsoft throughout the delivery, leveraging our Microsoft Gold Partner status to ensure best practice and maximise the value of Azure cloud technologies to support the programme > The data hub is crucial to the success of Helix as it underpins the other components of the programme, managing the data that other aspects of the service require, in order to accurately calculate balancing costs and provide settlement process back to suppliers.
  • 201.
  • 202.
    > 30 millionupdates (1.5 billion rows) per day > 10 TB working set CHALLENGES Large scale IOT- style data Long ramp-up period Complex and evolving interfaces Security > Scalable cost model over next 5-10 years > MHHS program in-flight > Legacy data flows > Large volume of PII
  • 203.
    > Maybe inthe future? PROBLEMS WE DON’T HAVE Exploratory data science Un-predictable scale Data sprawl Poor data quality > We’re bound by the number of houses in the UK > We have a small, well understood set of data types > Most of the data we receive has been pre-validated by upstream systems
  • 204.
    TECHNOLOGY CHOICE PRINCIPLES Azure FavourPAAS or SAAS over IAS Separate MHHS components should be separate systems
  • 205.
    A WORD ON“BIG DATA” PROCESSING Proprietary runtimes for open tools Spark (processing) Parquet / Delta / Avro (storage)
  • 206.
    AZURE DATA PROCESSING >Many, many products available! > Lots of different ways to solve the same problem > Assuming your data is big and parallelisable > Storage: ADLS, Parquet, Avro, Delta > Ingest: DataFactory (Integration), EventHubs (Streaming) > Processing: Spark > DataBricks or Synapse or Stream Analytics or DF Spark or… > POC a few, pick one. You can change later if you need to…
  • 207.
  • 208.
    WHERE NEXT? Helix > Completedevelopment work > Wait for the rest of MHHS to catch up > Industry testing (12 months) > Other data-intensive applications within Elexon > Data Governance requirements Re-use the data platform capability
  • 209.
    THANKS FOR YOURTIME Visit our stand for a chat Connect with us
  • 210.
    #digitnorth Raymond Setchfield Head ofTechnical Services, DataVita Richard Woodfield Director, RDB Concepts BREAKOUT D
  • 211.
  • 212.
    • Problem definition •Workload Locations and Types • Distributed workload support challenges • Problem Workloads • Use cases 1-3: • Problem - analysis - solutions Agenda
  • 213.
  • 214.
  • 215.
    On-Prem/DC SELF HOSTED APPS NewPOS SaaS API New Other SaaS API Data Warehouse Public or Private Cloud Normal Stuff Databases Sysadmin Patches Updates Networks Break Fix New Stuff Database appliances Hyperscaler Admin Hyperscaler workload costs APIs Complex ETL Multiple End Points Containers DevOps BI Work Loads Public Cloud Hybrid Clouds
  • 216.
    Key challenge thenis: • Transform to modern workloads • Maintain stability Most organisations will need help with this.
  • 217.
    • Legacy OS •Legacy Application Stack • Complicated Architecture • Licensing issues • Cross platform Workflows and ETL What about the problem workloads?
  • 218.
    The ideal supportpartner provides: • Connected infrastructure options across public, private, on-prem and SaaS • Can provide a Full Stack service across those platforms • Has a single point of contact for resolution across all platforms for: • Security, network, application and database level For modern workloads and legacy applications.
  • 219.
    • Strategic moveto Azure tenancy frustrated by core application vendor • API issues with Core Apps to SaaS providers • Oracle licence issues Use Case 1. (Small Bank) Solution: Oracle friendly HA cloud, with cross platform monitoring and support
  • 220.
    • Ancient stackand Infrastructure - end of life • Needed custom patching to bring stack up to current support levels • Move from traditional metal infrastructure to streamlined HA Database Optimised Cloud Use Case 2. (Large Website) Solution: Custom patching regime to new OS/Stack versions HA Database friendly cloud with full-resolving support.
  • 221.
    Business disruption causedchange in business needs - move to multi-franchise model Multiple POS systems introduced Move from IBM/Oracle to Legacy Cloud environment Flexible compute - near SaaS support and cross platform monitoring and workflow management Use Case 3. (High Street Restauranteur) Solution: Oracle friendly HA cloud, with cross platform monitoring and support
  • 222.
