Build Automation Best Practices
Daniel Sniderman – Lead Consultant

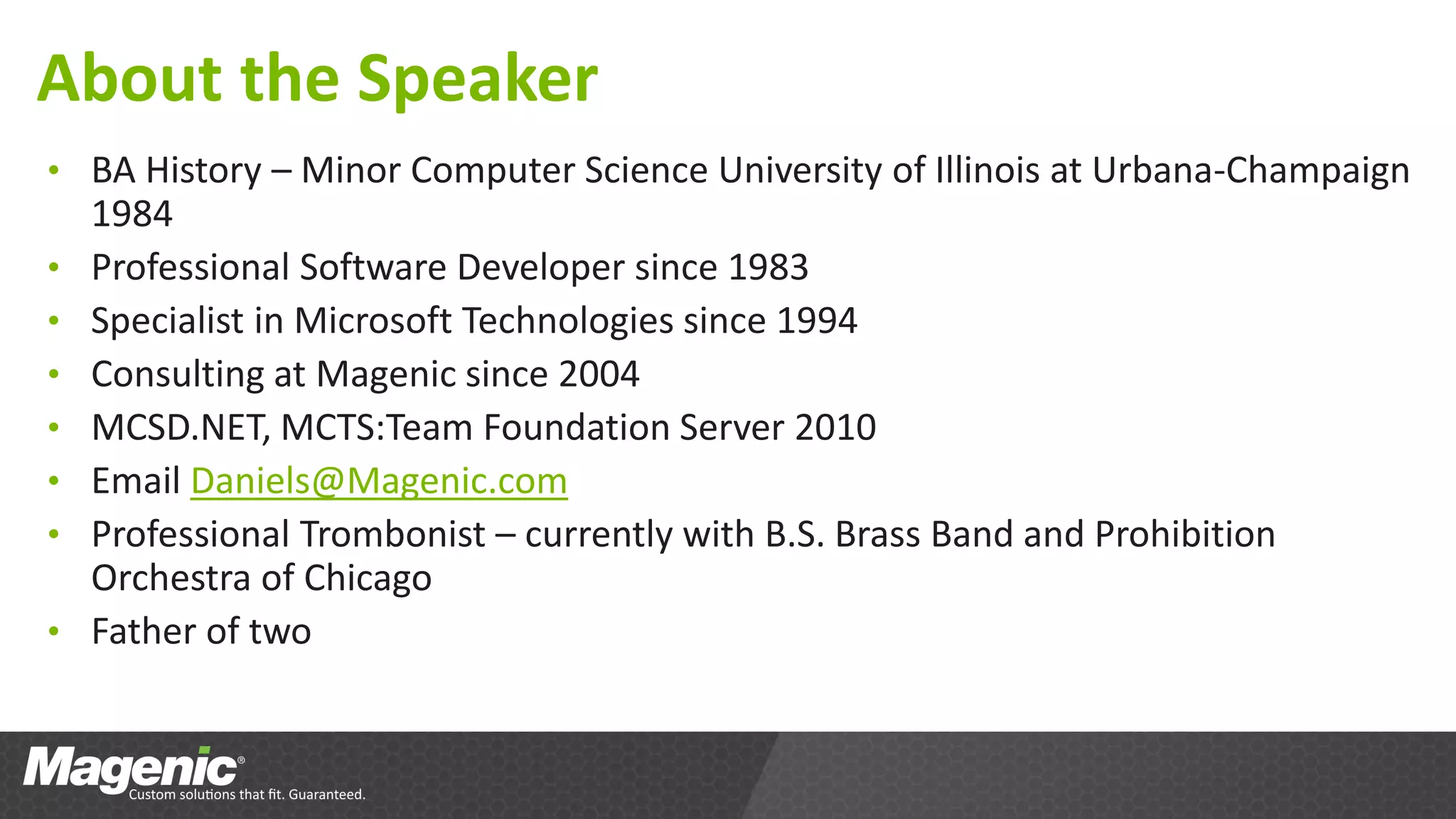

About the Speaker
• BA History – Minor Computer Science University of Illinois at Urbana-Champaign
    1984
•   Professional Software Developer since 1983
•   Specialist in Microsoft Technologies since 1994
•   Consulting at Magenic since 2004
•   MCSD.NET, MCTS:Team Foundation Server 2010
•   Email Daniels@Magenic.com
•   Professional Trombonist – currently with B.S. Brass Band and Prohibition
    Orchestra of Chicago
•   Father of two
Why Automate your Build?
• Do any of these sound familiar?
 – The instructions to build the application is a four page Word Document (if it
     even exists!).
 –   When the Lead Developer is on vacation, we can’t release the application.
 –   We’re never sure what version of the code is in our Dev, QA or Production
     Environments.
 –   We sometimes have errors because someone “fat fingers” a configuration
     change when going to a different environment
 –   It takes several hours to build and release our application
 –   One of the reasons we don’t have more releases (even to Dev/QA
     environments) is that it’s very time consuming to deploy a release.

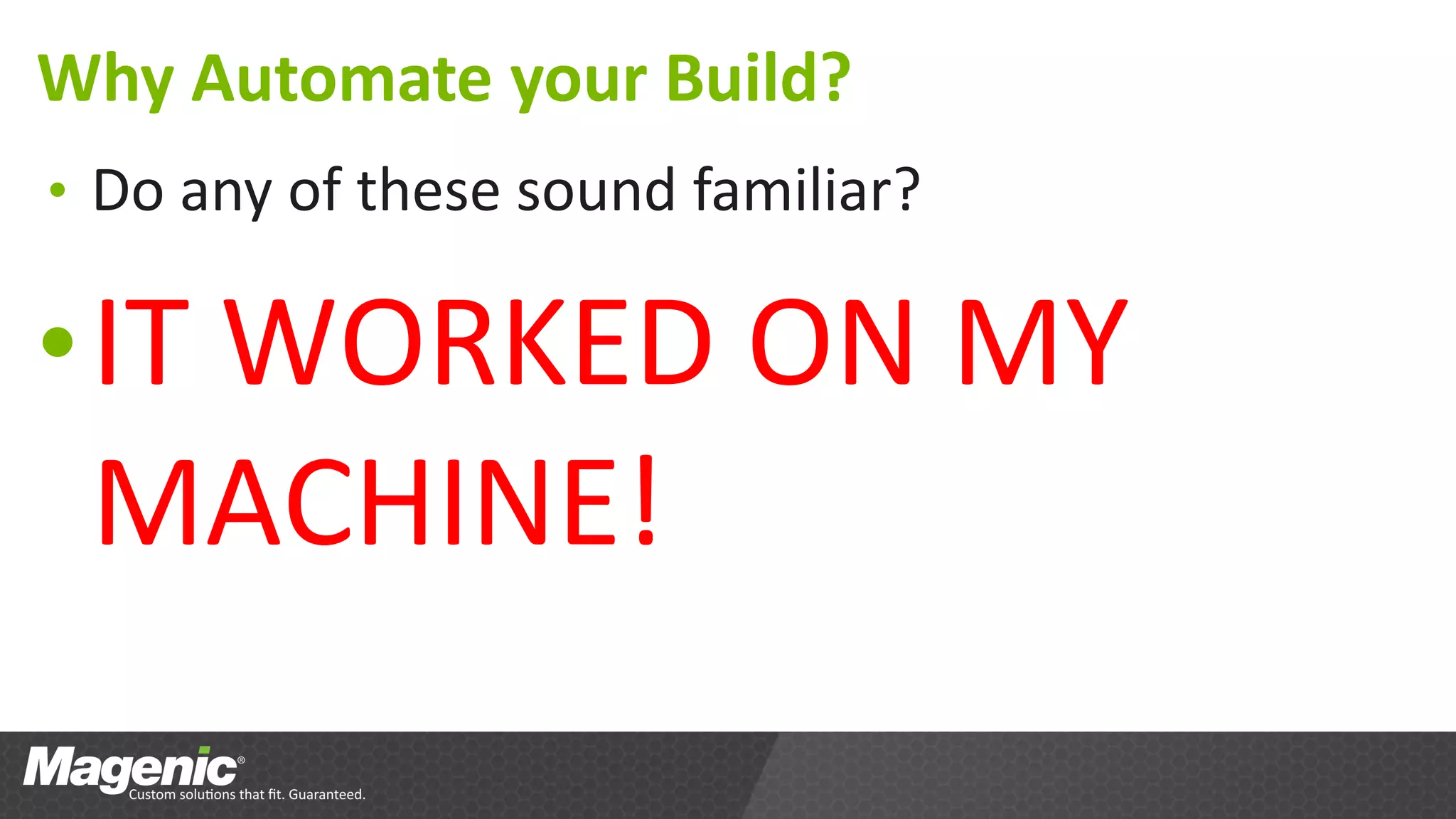

Why Automate your Build?
• Do any of these sound familiar?

• IT WORKED ON MY
 MACHINE!

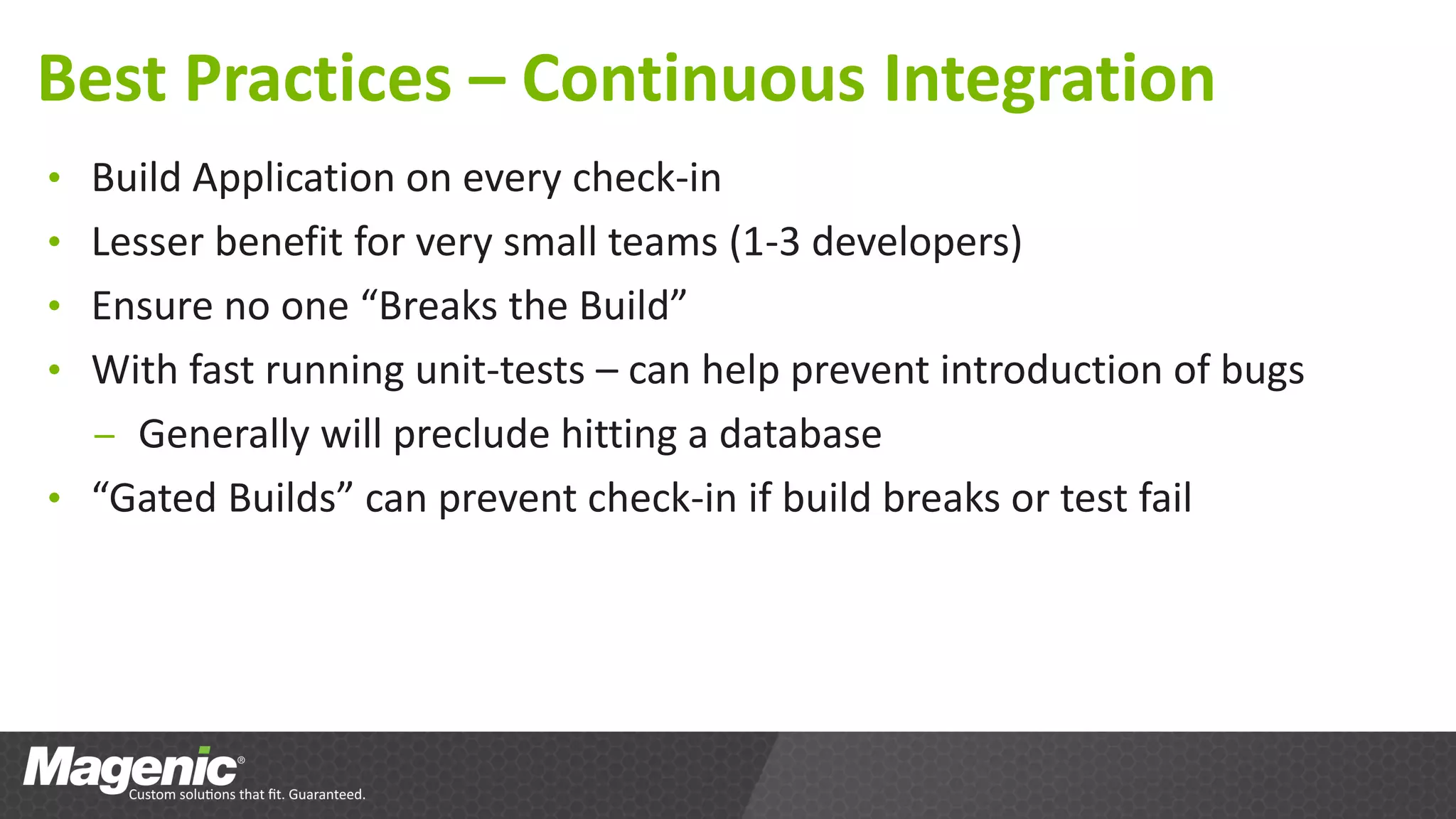

Best Practices – Continuous Integration
• Build Application on every check-in
• Lesser benefit for very small teams (1-3 developers)
• Ensure no one “Breaks the Build”
• With fast running unit-tests – can help prevent introduction of bugs
  – Generally will preclude hitting a database
• “Gated Builds” can prevent check-in if build breaks or test fail

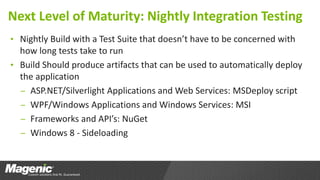

Next Level of Maturity: Nightly Integration Testing
• Nightly Build with a Test Suite that doesn’t have to be concerned with
  how long tests take to run
• Build Should produce artifacts that can be used to automatically deploy
  the application
  – ASP.NET/Silverlight Applications and Web Services: MSDeploy script
  – WPF/Windows Applications and Windows Services: MSI
  – Frameworks and API’s: NuGet
  – Windows 8 - Sideloading

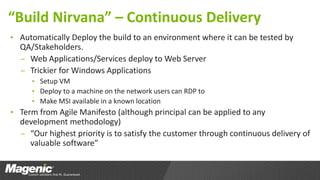

“Build Nirvana” – Continuous Delivery
• Automatically Deploy the build to an environment where it can be tested by
  QA/Stakeholders.
  – Web Applications/Services deploy to Web Server
  – Trickier for Windows Applications
     • Setup VM
     • Deploy to a machine on the network users can RDP to
     • Make MSI available in a known location
• Term from Agile Manifesto (although principal can be applied to any
  development methodology)
  – “Our highest priority is to satisfy the customer through continuous delivery of
    valuable software”
Common Build Automation Tools
• MSBuild
  – Introduced with VS2008: every xxproj file (csproj/vbproj) etc is a MSBuild script –
       used to determine order of compilation, automation etc
•   nAnt
    – Port of Java “ant” – commonly used before VS2008 and in some non-MSFT
       products.
•   Team Foundation Server
•   Team City
•   Cruise Control.NET (Open Source)
•   Hudson
•   Rake/pSake
•   Many others

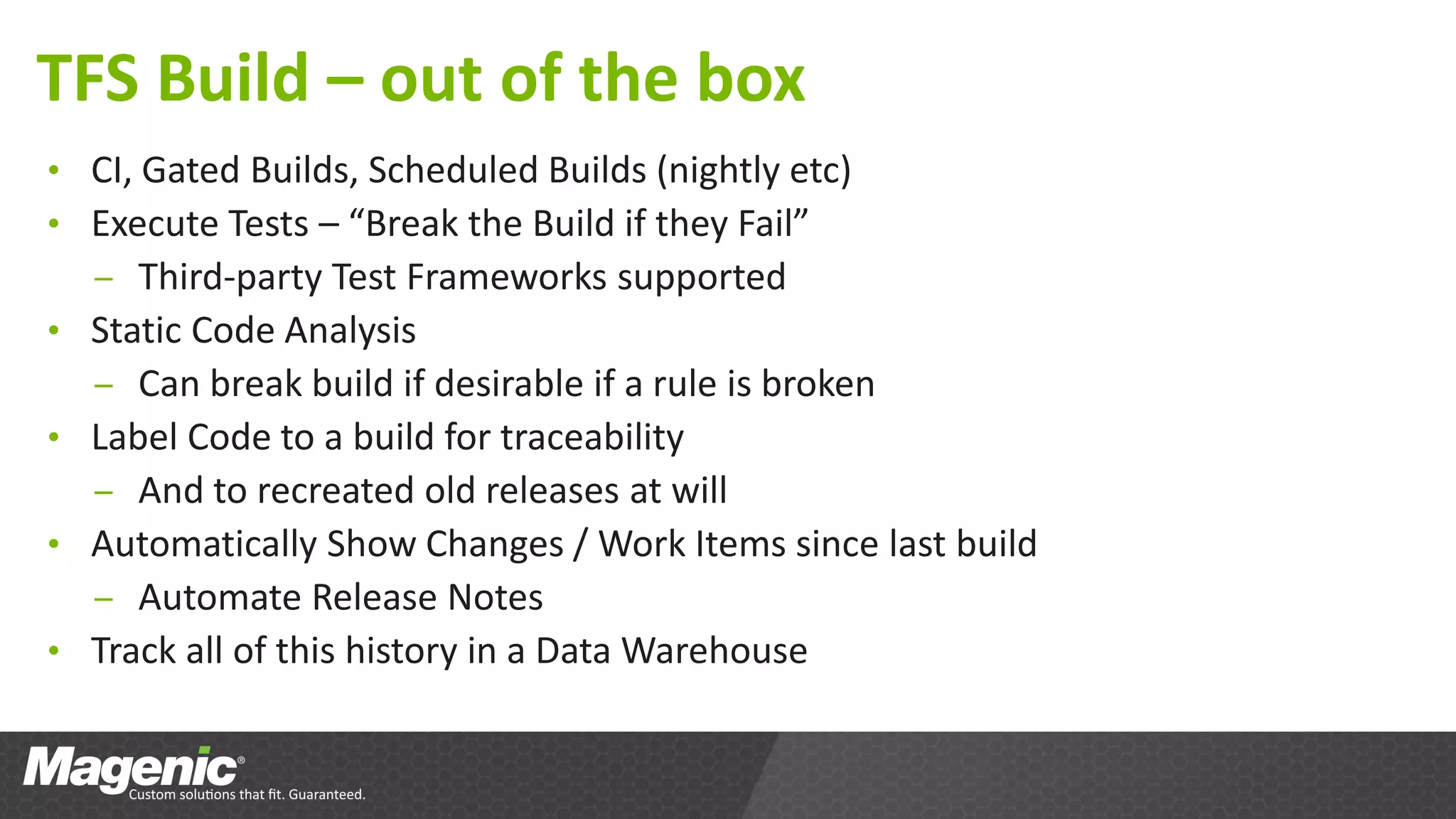

TFS Build – out of the box
• CI, Gated Builds, Scheduled Builds (nightly etc)
• Execute Tests – “Break the Build if they Fail”
  – Third-party Test Frameworks supported
• Static Code Analysis
  – Can break build if desirable if a rule is broken
• Label Code to a build for traceability
  – And to recreated old releases at will
• Automatically Show Changes / Work Items since last build
  – Automate Release Notes
• Track all of this history in a Data Warehouse
Common Build Automations
• Increment Version Number
  – .Net Standard: Major.Minor.Build.Revision such as “14.0.6024.1000” for
       Windows Word
•   Include that Version Number in the “Build Name” for History and Labeling
•   Update AssemblyInfo to include the version #, (Copyright Date etc) to stamp all
    DLL’s/EXE’s
•   Configuration Management is a must:
    – Config or any other files that need to be changed per environment
•   Copy build artifacts to FTP server if network boundary prevent automated
    deployment

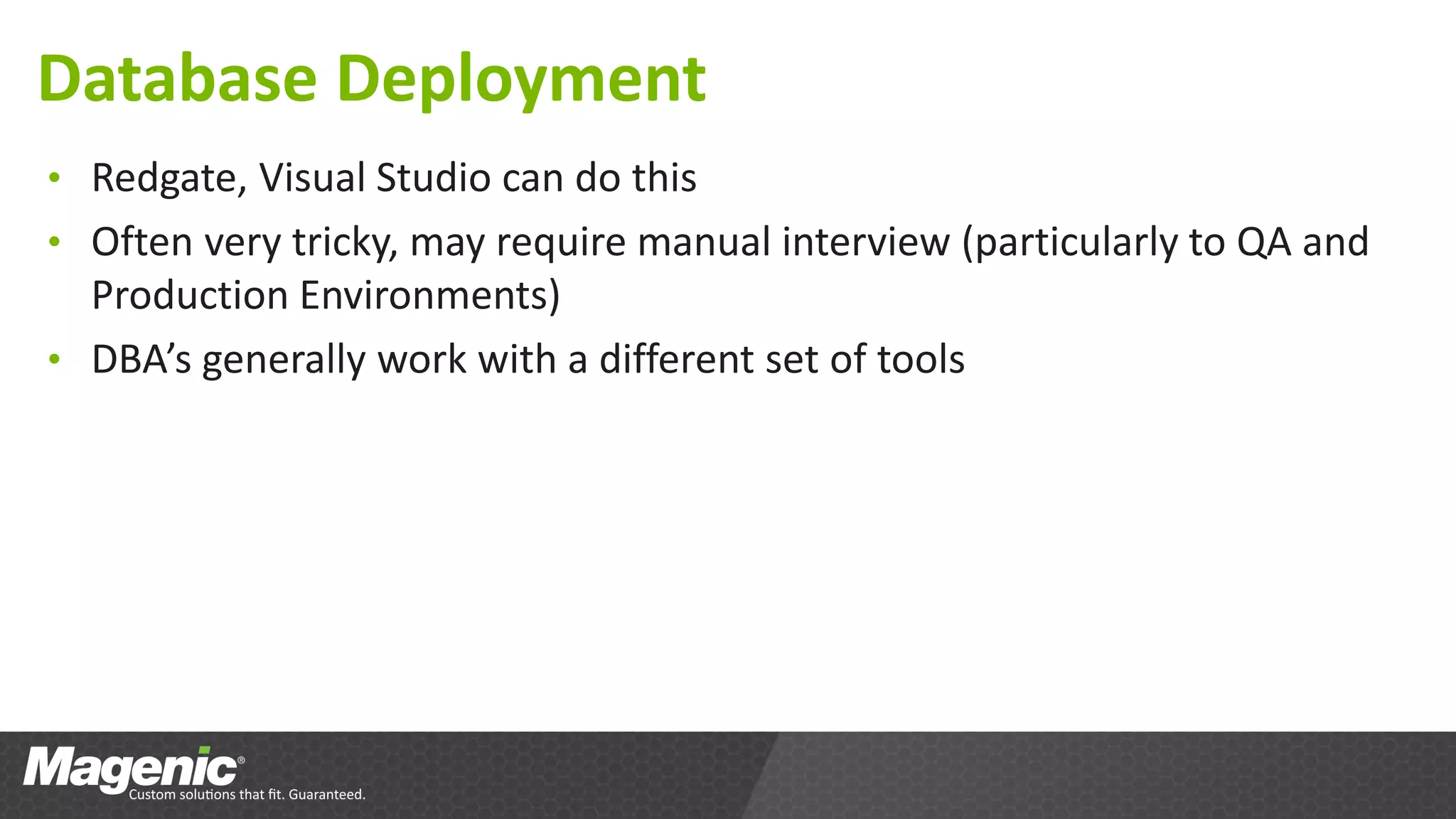

Database Deployment
• Redgate, Visual Studio can do this
• Often very tricky, may require manual interview (particularly to QA and
  Production Environments)
• DBA’s generally work with a different set of tools

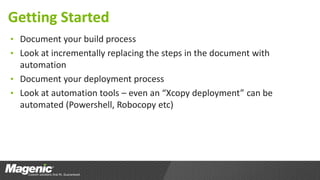

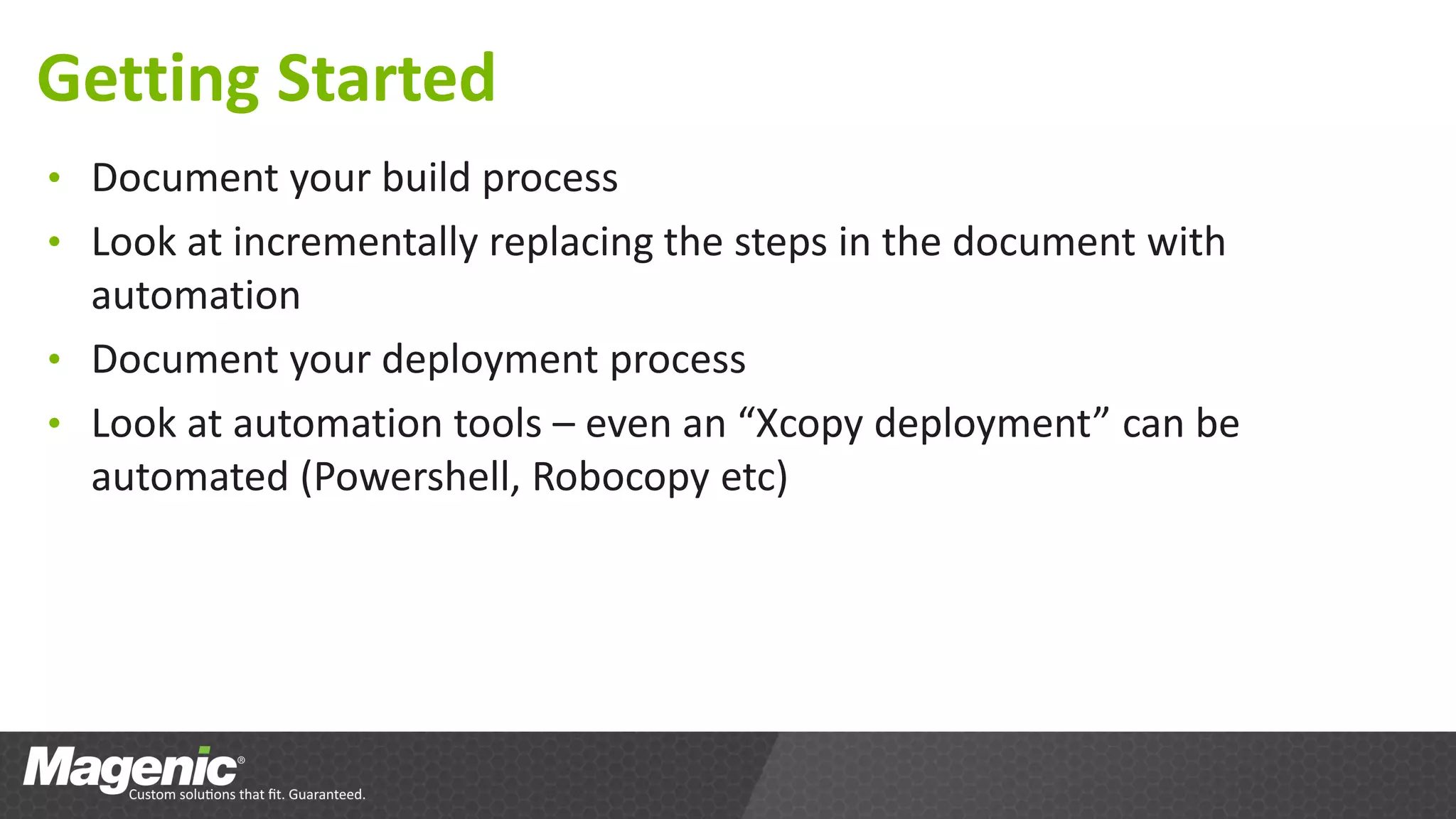

Getting Started
• Document your build process
• Look at incrementally replacing the steps in the document with
  automation
• Document your deployment process
• Look at automation tools – even an “Xcopy deployment” can be
  automated (Powershell, Robocopy etc)
Resources TFS
• MSDN: Configuring and Managing your build system:
  http://msdn.microsoft.com/en-us/library/ms252495
• “Inside the Microsoft Build Engine: Using MSBuild and Team Foundation Server
  http://www.amazon.com/Inside-Microsoft-Build-Engine-
  Foundation/dp/0735645248/ref=sr_1_1?ie=UTF8&qid=1347417109&sr=8-
  1&keywords=team+foundation+build (current to TFS2010)
• Professional Team Foundation Server 2012
  http://www.amazon.com/Professional-Team-Foundation-Server-
  2012/dp/1118314093/ref=sr_1_1?ie=UTF8&qid=1347417173&sr=8-
  1&keywords=team+foundation+server+2012
  – TFS 2010 version available now
  – TFS 2012 version available Jan 2013
Resources Continuous Delivery
• http://www.continuousdelivery.com/
• “Continuous Delivery : Reliable Software Releases through Build, Test and
  Deployment Automation”
  http://www.amazon.com/dp/0321601912?tag=contindelive-20
