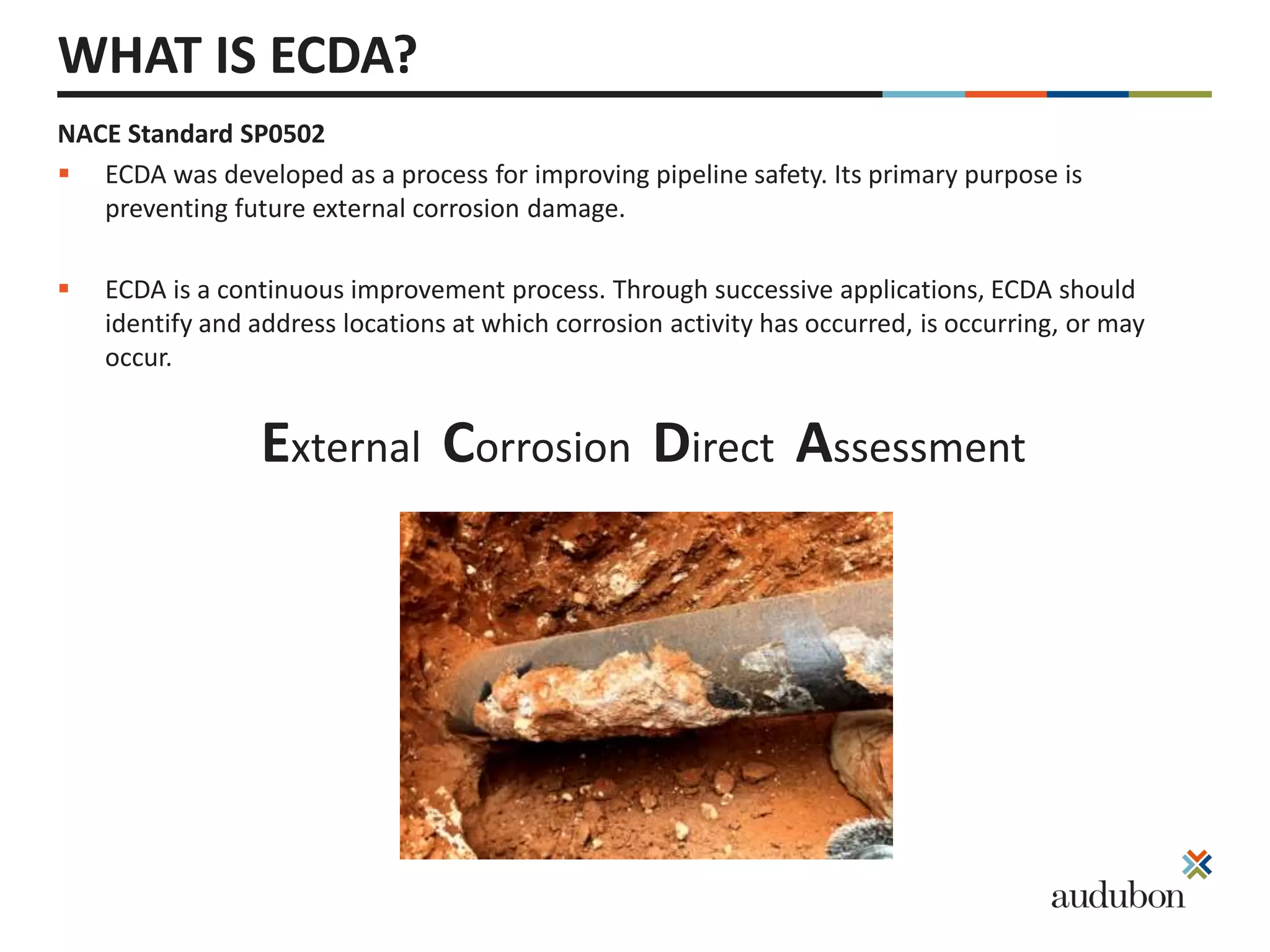

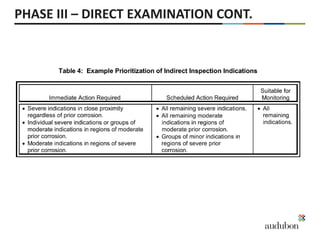

The document provides an overview of external corrosion direct assessment (ECDA). It summarizes the four phases of ECDA: pre-assessment, indirect inspection, direct examination, and post-assessment. The pre-assessment phase involves collecting pipeline data and selecting indirect inspection tools. Indirect inspections are then performed to identify corrosion indications, followed by direct excavations to validate findings. Finally, the post-assessment phase includes calculations, defining reassessment intervals, and continuous improvement. The presentation is delivered by Matthew Myers, an experienced pipeline integrity and corrosion expert.
The document provides guidance on conducting consistent atmospheric inspections for corrosion. It emphasizes using consistent language to describe visual observations, asset identification, and condition assessments. Inspectors should clearly understand the level of detail required and describe assets, locations, and conditions in a standardized way. This ensures all inspectors perceive and report the same when evaluating the same assets.
Direct Assessment ECDA Program DevelopmentMTS Webmaster
The document discusses the requirements and process for conducting an external corrosion direct assessment (ECDA) on gas transmission pipelines located in high consequence areas. The key points are:
1. An ECDA involves a 4-step process of pre-assessment, indirect examinations, direct examinations, and post-assessment to evaluate external corrosion risk.
2. The pre-assessment step involves collecting pipeline data and using it to identify ECDA regions and select appropriate indirect inspection tools.
3. Indirect inspections are then conducted using two or more tools to identify and classify corrosion indications by severity. Direct examinations are then focused on the most severe indications.

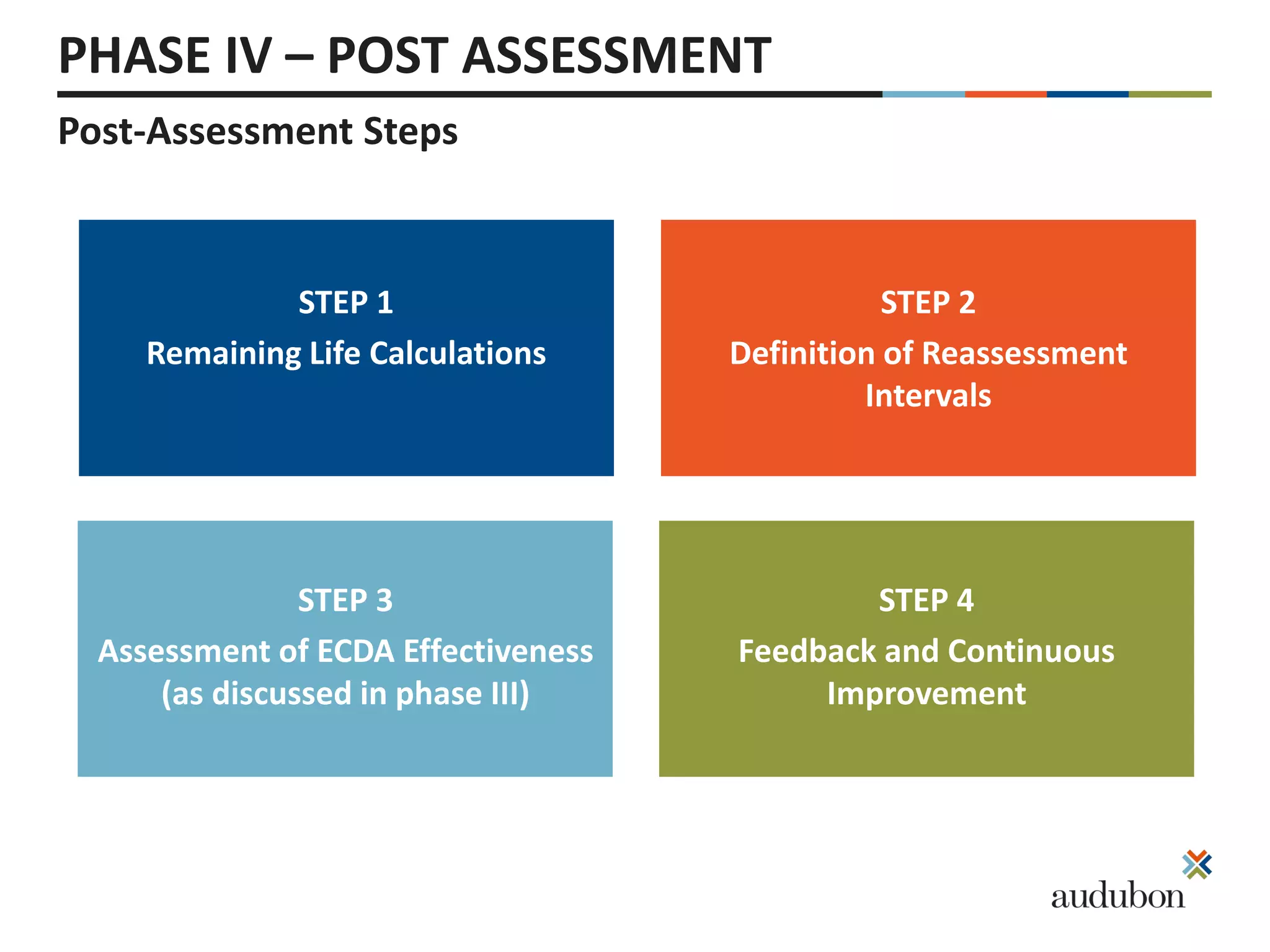

4. The post-assessment step defines reassessment intervals
The document discusses an enhanced pipeline risk assessment (EPRA) model for evaluating risks on pipelines. EPRA uses measurements rather than scores to provide a more accurate and defensible quantitative risk assessment that can be expressed in absolute terms. EPRA assesses probability of failure based on exposure, mitigation, and resistance factors, allowing for a more detailed, data-driven analysis of risk compared to typical qualitative or relative scoring models.
This document discusses health and safety in the oil and gas industry. It covers several topics:
- Management systems for health and safety with planning, performance, assessment, and improvement.
- Personal protective equipment (PPE) including responsibilities, hazard assessment, protective clothing, and training.
- Electrical safety including responsibilities, hazards, flash hazard analysis, and qualifications.
- Control of hazardous energy sources including lockout procedures.
- Emergency contingency planning including different plans for shelter in place, administrative closings, and occupant emergencies.
This document provides an introduction to the US codes and standards for pressure piping inspection. It outlines the key documents referenced in API 570 for in-service inspection, including ASME B31.3 for design, ASME Section V for non-destructive examination, ASME Section IX for welding, and ASME B16.5 for flanges. API 570 serves as the overarching standard for in-service inspection, repair, alteration and rerating of pressure piping, and references these other codes and standards to provide guidance across the lifecycle of pressure piping systems. The introduction discusses the relationship between the various codes and when they are applicable.
The document is an inspection report of an electrical transfer pump. It summarizes:
1) An inspection was conducted of the pump which included document verification, functional testing at low and high pressures, and verification of calibration certificates.
2) The inspection found the pump to be in good working order, but the bourdon pressure gauge serial number was not marked and needed replacing to meet requirements.
3) Non-conformances were identified regarding certification and testing of the lifting skid and accessories that support the pump. Corrective actions were recommended to address these issues.
This document discusses corrosion monitoring and crack monitoring techniques for condition monitoring of machines. It describes several common corrosion monitoring methods like weight loss, electrical resistance, linear polarization, and ultrasonic testing. It also discusses some crack monitoring methods like visual inspection and non-destructive testing techniques like penetrant testing, magnetic particle testing, and ultrasonic testing. The goal is to monitor deterioration rates and measure changes in crack width over time to assess structural integrity.
Construction safety pocket guide osha3252zul husni
This document discusses hazards and solutions for various safety issues in the construction industry. It addresses common hazards like falls, trench collapses, scaffolding failures, electrocutions, and more. For each hazard, it provides 2-3 potential solutions, such as using fall protection equipment, properly sloping trenches, inspecting scaffolding, and establishing lockout/tagout procedures for electrical work. The purpose is to educate construction workers about workplace dangers and how to prevent injuries and fatalities through safe practices.
The document provides guidance on conducting consistent atmospheric inspections for corrosion. It emphasizes using consistent language to describe visual observations, asset identification, and condition assessments. Inspectors should clearly understand the level of detail required and describe assets, locations, and conditions in a standardized way. This ensures all inspectors perceive and report the same when evaluating the same assets.
Direct Assessment ECDA Program DevelopmentMTS Webmaster
The document discusses the requirements and process for conducting an external corrosion direct assessment (ECDA) on gas transmission pipelines located in high consequence areas. The key points are:
1. An ECDA involves a 4-step process of pre-assessment, indirect examinations, direct examinations, and post-assessment to evaluate external corrosion risk.
2. The pre-assessment step involves collecting pipeline data and using it to identify ECDA regions and select appropriate indirect inspection tools.
3. Indirect inspections are then conducted using two or more tools to identify and classify corrosion indications by severity. Direct examinations are then focused on the most severe indications.
4. The post-assessment step defines reassessment intervals
The document discusses an enhanced pipeline risk assessment (EPRA) model for evaluating risks on pipelines. EPRA uses measurements rather than scores to provide a more accurate and defensible quantitative risk assessment that can be expressed in absolute terms. EPRA assesses probability of failure based on exposure, mitigation, and resistance factors, allowing for a more detailed, data-driven analysis of risk compared to typical qualitative or relative scoring models.
This document discusses health and safety in the oil and gas industry. It covers several topics:
- Management systems for health and safety with planning, performance, assessment, and improvement.
- Personal protective equipment (PPE) including responsibilities, hazard assessment, protective clothing, and training.
- Electrical safety including responsibilities, hazards, flash hazard analysis, and qualifications.
- Control of hazardous energy sources including lockout procedures.
- Emergency contingency planning including different plans for shelter in place, administrative closings, and occupant emergencies.
This document provides an introduction to the US codes and standards for pressure piping inspection. It outlines the key documents referenced in API 570 for in-service inspection, including ASME B31.3 for design, ASME Section V for non-destructive examination, ASME Section IX for welding, and ASME B16.5 for flanges. API 570 serves as the overarching standard for in-service inspection, repair, alteration and rerating of pressure piping, and references these other codes and standards to provide guidance across the lifecycle of pressure piping systems. The introduction discusses the relationship between the various codes and when they are applicable.
The document is an inspection report of an electrical transfer pump. It summarizes:
1) An inspection was conducted of the pump which included document verification, functional testing at low and high pressures, and verification of calibration certificates.
2) The inspection found the pump to be in good working order, but the bourdon pressure gauge serial number was not marked and needed replacing to meet requirements.
3) Non-conformances were identified regarding certification and testing of the lifting skid and accessories that support the pump. Corrective actions were recommended to address these issues.
This document discusses corrosion monitoring and crack monitoring techniques for condition monitoring of machines. It describes several common corrosion monitoring methods like weight loss, electrical resistance, linear polarization, and ultrasonic testing. It also discusses some crack monitoring methods like visual inspection and non-destructive testing techniques like penetrant testing, magnetic particle testing, and ultrasonic testing. The goal is to monitor deterioration rates and measure changes in crack width over time to assess structural integrity.
Construction safety pocket guide osha3252zul husni
This document discusses hazards and solutions for various safety issues in the construction industry. It addresses common hazards like falls, trench collapses, scaffolding failures, electrocutions, and more. For each hazard, it provides 2-3 potential solutions, such as using fall protection equipment, properly sloping trenches, inspecting scaffolding, and establishing lockout/tagout procedures for electrical work. The purpose is to educate construction workers about workplace dangers and how to prevent injuries and fatalities through safe practices.
The document provides a hydro test procedure for newly constructed pipeline as part of the Berri Development Onshore Flowlines & Tie Ins Project in Saudi Arabia. It outlines responsibilities for the hydro test, describes test preparation including submittals required, testing components, and safety precautions. The procedure specifies filling the system with water, applying and maintaining test pressure, inspecting for leaks, and draining/drying upon completion.
Mechanical integrity and reliability centered maintenance programs are important to ensure critical process equipment functions properly and operates safely. A reliability centered maintenance program was presented that examines equipment functions and failure modes to prioritize maintenance tasks. Hazard and operability studies and risk based inspections are other programs that identify risks. Risk based inspection involves assessing the probability and consequences of equipment failures to determine inspection intervals and methods needed to mitigate risks.
FULL BODY HARNESS INSPECTION RECORD Form # HSEQ - FBHIR Rev 2.docxDwarika Bhushan Sharma
Harness Checklist
Sl. No
………. Sl. No
………. Sl. No
………. Sl. No
………. Sl. No
………. Sl. No
………. Sl. No
………. Sl. No
………. Sl. No
………. Remarks
Shoulder Straps
Chest & Back Straps
Waist Straps
Back D-Ring
Shoulder Adjustment
Legible Label
Shoulder Straps
Chest & Back Straps
Waist Straps
Leg Straps
Cuts
Burns
Holes
Deterioration
Corrosive/ worn out
Color code
Others (Specify)
Project Information
Project Name: Location:
Company name : Date:
Remarks:
Inspector Name: Signature:
Reviewed By HSE Manager / Incharge Signature:
Pneumatic testing involves higher risks than hydrostatic testing due to the compressibility and stored potential energy of air. A minor leak during pneumatic testing can lead to a rapid rupture and explosion before remedial action can be taken. Hydrostatic testing uses incompressible water, stores much less energy, and allows leaks to be detected sooner through a pressure drop. Proper procedures and safety precautions are required when conducting pneumatic tests to prevent damage and injury.
This document provides a risk assessment for hydro testing and pressure testing of pipe works conducted by Arabian Bemco Contracting Co. It identifies several hazards associated with the work including high pressure leaks, over pressure, slips trips and falls. For each hazard, it lists the persons at risk, initial risk rating, and proposed control measures to reduce the risk. The control measures include training, use of personal protective equipment, safety signage, permitting, and having emergency response measures in place.
Introduction to Non Destructive Testing. Various Advantages, and also covers the 6 principal methods of Non Destructive Testing and their applications and limitations.
This document provides the Health, Safety and Environmental (HSE) Management Manual for Consolidated Construction Consortium Ltd. (CCCL). It outlines CCCL's HSE management system, which is in compliance with OHSAS 18001 and ISO 14001 standards. The manual covers CCCL's HSE policy, planning, implementation, operation, monitoring and corrective action processes. It also includes the organization profile, objectives, responsibilities and documentation requirements of the HSE management system.
Cold stretching has been in use for more than 30 years, but not under ASME code rules until 2008(Code Case 2596). Cold stretching (or cold working) increases the yield limit of a stainless steel material by work hardening it after all forming and welded steps are complete. A vessel can be cold stretched by over pressurizing it 1.5 to 1.6 times design pressure under careful control of the deformation vs pressure as outlined in VIII-1 App 44. The resulting permanent plastic deformation increases the diameter up to 7% and the volume by 14%.
The aim of this guide is to furnish Engineers, Technicians, Supervisors and Managers (that are involved in maintenance activities & planning) with a tool which equips them with technical data and information, often required for effective Maintenance works (especially on Valves); with applications in other areas, such as maintenance of: Pipelines, Pumps, Actuators, Wellhead Equipments etc. Sure you’d find this material useful.
Este documento establece las directrices para el Sistema de Permisos para Trabajos con Riesgo en las instalaciones de Pemex Exploración y Producción. Describe los requisitos, roles, responsabilidades y actividades para aplicar el sistema de permisos y administrar los riesgos en trabajos rutinarios y no rutinarios. También incluye definiciones clave y procedimientos para la elaboración, autorización, supervisión y cancelación de permisos para trabajos con riesgo.
Occupational exposure limits (OEL) to chemical agents APIs - Quantitative Ris...Azierta
The Occupational Exposure Limit (OEL) is defined as the airborne concentration of a substance (expressed as a weighted average in time for a working day of 8 hours/day and 40 hours/working week) under which it is believed that nearly all workers may be repeatedly exposed (day after day, over a working lifetime) without adverse health effects (ACGIH, 2006; DFG, 2005).
Occupational exposure limits (OELs) are a useful tool to prevent adverse effects on health when managing chemical substances.
On a European scale…
• Employers are legally obliged to provide a work environment that does not threaten the health of the workers (Chemical Agent Directive 98/24/EC and Framework Directive 89/391/EEC).
• Under Directive 89/391/EEC, OELs can be developed nationally, Indicative Occupational Exposure Limit Values (IOELVs).
Interview questions and answers for welding inspectortonyron13
This document provides sample interview questions for welders. It lists common questions asked about a candidate's background, work history, weaknesses, and welding experience. Specific technical questions are also provided about welding processes, equipment, and stresses. The document advises welding candidates to prepare answers to typical interview questions about themselves and their qualifications in order to avoid surprises and effectively showcase their suitability for the role.
What is JSA?
A Job Safety Analysis is a task-oriented risk assessment used to review the hazards associated with a particular work task, and to verify that adequate safeguards are in place to control those hazards.
JSAs are known by a variety of terms, including Job Hazard Analysis (JHA), Job Risk Assessment (JRA), Task Risk Assessment (TRA), Safe Job Analysis (SJA).
Job Safety Analysis and its Implementation
INVOLVE employees in the development
KEEP written JSA short and simple
ILLUSTRATE safe practices
ASSIGN responsibility of JSA
TRAIN all employees and supervisors
EXPLAIN the use of JSA to employees
IMPLEMENT safe work practices
REVIEW JSA when equipment or process changes or new information becomes available regarding potential hazards associated with the job.
Piping and instrumentation diagrams (P&IDs) are complex diagrams that show the piping, instrumentation, and process flow in chemical plants. The presentation discusses P&IDs in detail, including:
1. The purpose of P&IDs in understanding chemical processes, operations, and maintenance.
2. The various standards and symbols used to represent equipment, piping, instruments, and their interconnectivity.
3. How P&IDs are developed through various stages and used by different engineering departments and industries for design and operations.
4. Examples of software that can be used to create detailed P&IDs.
API 570 provides guidance for inspecting, repairing, altering, and rerating in-service piping systems. It covers metallic and FRP piping systems used in process facilities for fluids like petroleum products, gases, and hazardous materials. The document establishes requirements for inspection plans, examining piping and components, evaluating inspection data, making repairs, and setting inspection intervals. It aims to ensure the safe operation of in-service piping by maintaining its structural integrity over time.
The document provides an overview and introduction to pipeline projects for pipeline project engineers. It discusses various topics related to pipelines including different modes of petroleum product transportation, advantages of pipeline transportation, cross-country pipelines in India, HPCL's pipeline network, and basic pipeline system components. The course aims to help engineers understand their role and provide foundational knowledge of pipelines. It includes modules on pipeline overview, HPCL pipelines, and a knowledge assessment.
The document discusses corrosion control techniques for underground pipelines, including coatings, cathodic protection, and chemical inhibitors. It outlines the objectives of minimizing corrosion to increase pipeline lifespan and safety. Key techniques are summarized, such as using coatings as a barrier between the pipeline and environment, cathodic protection methods like galvanic anodes and impressed current, and chemical inhibitors. Field surveys like pipe-to-soil potential and close interval potential surveys are described. Experimental work involved performing these surveys on various pipelines and coating inspection. The conclusion emphasizes the importance of corrosion control for oil/gas pipelines and following standards like NACE for cathodic protection.
A System to manage Contractor/Sub-Contractor from HSE perspective start from contractor selection until contract end to achieve health and safe working environment
This document provides an overview of risk-based inspection (RBI) methodology. It defines RBI and compares it to other inspection methods. It outlines the key elements and benefits of an RBI program, including optimizing inspection costs, improving safety, and increasing availability. The document discusses international RBI standards and outlines the RBI planning process, including collecting equipment data, identifying damage mechanisms, analyzing risk, developing inspection plans, and reassessing over time. It also briefly introduces some RBI software options.
White Paper Available from the PPIM Conference: Pipeline Regulation and Dire...Willbros Group, Inc.
Willbros and NiSource white paper from PPIM, the industry's only forum devoted to pigging for maintenance and inspection; pipeline integrity evaluation and repair. http://pipelineintegrity.willbros.com
Advanced Pipeline Risk Assessment vs. Simplified NACE StandardsDavid Richardson
NACE - ICDA standards for wet-gas and normally dry gas are founded on our ICPT-PM advanced hazard modelling algorithms.
ICPT-PM pin-points the most probable locations of corrosion and the severity of corrosion damage accumulated over-life metal loss along the pipeline; prioritized regions for integrity validation.
ICPT-PM provides mitigation guidance for Production Operations
action to prevent corrosion initiation action plan to prevent growth of pre-existing corrosion damage.
The document provides a hydro test procedure for newly constructed pipeline as part of the Berri Development Onshore Flowlines & Tie Ins Project in Saudi Arabia. It outlines responsibilities for the hydro test, describes test preparation including submittals required, testing components, and safety precautions. The procedure specifies filling the system with water, applying and maintaining test pressure, inspecting for leaks, and draining/drying upon completion.
Mechanical integrity and reliability centered maintenance programs are important to ensure critical process equipment functions properly and operates safely. A reliability centered maintenance program was presented that examines equipment functions and failure modes to prioritize maintenance tasks. Hazard and operability studies and risk based inspections are other programs that identify risks. Risk based inspection involves assessing the probability and consequences of equipment failures to determine inspection intervals and methods needed to mitigate risks.
FULL BODY HARNESS INSPECTION RECORD Form # HSEQ - FBHIR Rev 2.docxDwarika Bhushan Sharma
Harness Checklist
Sl. No
………. Sl. No
………. Sl. No
………. Sl. No
………. Sl. No
………. Sl. No
………. Sl. No
………. Sl. No
………. Sl. No
………. Remarks
Shoulder Straps
Chest & Back Straps
Waist Straps
Back D-Ring
Shoulder Adjustment
Legible Label
Shoulder Straps
Chest & Back Straps
Waist Straps
Leg Straps
Cuts
Burns
Holes
Deterioration
Corrosive/ worn out
Color code
Others (Specify)
Project Information
Project Name: Location:
Company name : Date:
Remarks:
Inspector Name: Signature:
Reviewed By HSE Manager / Incharge Signature:
Pneumatic testing involves higher risks than hydrostatic testing due to the compressibility and stored potential energy of air. A minor leak during pneumatic testing can lead to a rapid rupture and explosion before remedial action can be taken. Hydrostatic testing uses incompressible water, stores much less energy, and allows leaks to be detected sooner through a pressure drop. Proper procedures and safety precautions are required when conducting pneumatic tests to prevent damage and injury.
This document provides a risk assessment for hydro testing and pressure testing of pipe works conducted by Arabian Bemco Contracting Co. It identifies several hazards associated with the work including high pressure leaks, over pressure, slips trips and falls. For each hazard, it lists the persons at risk, initial risk rating, and proposed control measures to reduce the risk. The control measures include training, use of personal protective equipment, safety signage, permitting, and having emergency response measures in place.
Introduction to Non Destructive Testing. Various Advantages, and also covers the 6 principal methods of Non Destructive Testing and their applications and limitations.
This document provides the Health, Safety and Environmental (HSE) Management Manual for Consolidated Construction Consortium Ltd. (CCCL). It outlines CCCL's HSE management system, which is in compliance with OHSAS 18001 and ISO 14001 standards. The manual covers CCCL's HSE policy, planning, implementation, operation, monitoring and corrective action processes. It also includes the organization profile, objectives, responsibilities and documentation requirements of the HSE management system.
Cold stretching has been in use for more than 30 years, but not under ASME code rules until 2008(Code Case 2596). Cold stretching (or cold working) increases the yield limit of a stainless steel material by work hardening it after all forming and welded steps are complete. A vessel can be cold stretched by over pressurizing it 1.5 to 1.6 times design pressure under careful control of the deformation vs pressure as outlined in VIII-1 App 44. The resulting permanent plastic deformation increases the diameter up to 7% and the volume by 14%.
The aim of this guide is to furnish Engineers, Technicians, Supervisors and Managers (that are involved in maintenance activities & planning) with a tool which equips them with technical data and information, often required for effective Maintenance works (especially on Valves); with applications in other areas, such as maintenance of: Pipelines, Pumps, Actuators, Wellhead Equipments etc. Sure you’d find this material useful.
Este documento establece las directrices para el Sistema de Permisos para Trabajos con Riesgo en las instalaciones de Pemex Exploración y Producción. Describe los requisitos, roles, responsabilidades y actividades para aplicar el sistema de permisos y administrar los riesgos en trabajos rutinarios y no rutinarios. También incluye definiciones clave y procedimientos para la elaboración, autorización, supervisión y cancelación de permisos para trabajos con riesgo.
Occupational exposure limits (OEL) to chemical agents APIs - Quantitative Ris...Azierta
The Occupational Exposure Limit (OEL) is defined as the airborne concentration of a substance (expressed as a weighted average in time for a working day of 8 hours/day and 40 hours/working week) under which it is believed that nearly all workers may be repeatedly exposed (day after day, over a working lifetime) without adverse health effects (ACGIH, 2006; DFG, 2005).
Occupational exposure limits (OELs) are a useful tool to prevent adverse effects on health when managing chemical substances.
On a European scale…
• Employers are legally obliged to provide a work environment that does not threaten the health of the workers (Chemical Agent Directive 98/24/EC and Framework Directive 89/391/EEC).
• Under Directive 89/391/EEC, OELs can be developed nationally, Indicative Occupational Exposure Limit Values (IOELVs).
Interview questions and answers for welding inspectortonyron13
This document provides sample interview questions for welders. It lists common questions asked about a candidate's background, work history, weaknesses, and welding experience. Specific technical questions are also provided about welding processes, equipment, and stresses. The document advises welding candidates to prepare answers to typical interview questions about themselves and their qualifications in order to avoid surprises and effectively showcase their suitability for the role.
What is JSA?
A Job Safety Analysis is a task-oriented risk assessment used to review the hazards associated with a particular work task, and to verify that adequate safeguards are in place to control those hazards.
JSAs are known by a variety of terms, including Job Hazard Analysis (JHA), Job Risk Assessment (JRA), Task Risk Assessment (TRA), Safe Job Analysis (SJA).
Job Safety Analysis and its Implementation
INVOLVE employees in the development
KEEP written JSA short and simple
ILLUSTRATE safe practices
ASSIGN responsibility of JSA
TRAIN all employees and supervisors
EXPLAIN the use of JSA to employees
IMPLEMENT safe work practices
REVIEW JSA when equipment or process changes or new information becomes available regarding potential hazards associated with the job.
Piping and instrumentation diagrams (P&IDs) are complex diagrams that show the piping, instrumentation, and process flow in chemical plants. The presentation discusses P&IDs in detail, including:
1. The purpose of P&IDs in understanding chemical processes, operations, and maintenance.
2. The various standards and symbols used to represent equipment, piping, instruments, and their interconnectivity.
3. How P&IDs are developed through various stages and used by different engineering departments and industries for design and operations.
4. Examples of software that can be used to create detailed P&IDs.
API 570 provides guidance for inspecting, repairing, altering, and rerating in-service piping systems. It covers metallic and FRP piping systems used in process facilities for fluids like petroleum products, gases, and hazardous materials. The document establishes requirements for inspection plans, examining piping and components, evaluating inspection data, making repairs, and setting inspection intervals. It aims to ensure the safe operation of in-service piping by maintaining its structural integrity over time.
The document provides an overview and introduction to pipeline projects for pipeline project engineers. It discusses various topics related to pipelines including different modes of petroleum product transportation, advantages of pipeline transportation, cross-country pipelines in India, HPCL's pipeline network, and basic pipeline system components. The course aims to help engineers understand their role and provide foundational knowledge of pipelines. It includes modules on pipeline overview, HPCL pipelines, and a knowledge assessment.
The document discusses corrosion control techniques for underground pipelines, including coatings, cathodic protection, and chemical inhibitors. It outlines the objectives of minimizing corrosion to increase pipeline lifespan and safety. Key techniques are summarized, such as using coatings as a barrier between the pipeline and environment, cathodic protection methods like galvanic anodes and impressed current, and chemical inhibitors. Field surveys like pipe-to-soil potential and close interval potential surveys are described. Experimental work involved performing these surveys on various pipelines and coating inspection. The conclusion emphasizes the importance of corrosion control for oil/gas pipelines and following standards like NACE for cathodic protection.
A System to manage Contractor/Sub-Contractor from HSE perspective start from contractor selection until contract end to achieve health and safe working environment
This document provides an overview of risk-based inspection (RBI) methodology. It defines RBI and compares it to other inspection methods. It outlines the key elements and benefits of an RBI program, including optimizing inspection costs, improving safety, and increasing availability. The document discusses international RBI standards and outlines the RBI planning process, including collecting equipment data, identifying damage mechanisms, analyzing risk, developing inspection plans, and reassessing over time. It also briefly introduces some RBI software options.
White Paper Available from the PPIM Conference: Pipeline Regulation and Dire...Willbros Group, Inc.
Willbros and NiSource white paper from PPIM, the industry's only forum devoted to pigging for maintenance and inspection; pipeline integrity evaluation and repair. http://pipelineintegrity.willbros.com
Advanced Pipeline Risk Assessment vs. Simplified NACE StandardsDavid Richardson
NACE - ICDA standards for wet-gas and normally dry gas are founded on our ICPT-PM advanced hazard modelling algorithms.
ICPT-PM pin-points the most probable locations of corrosion and the severity of corrosion damage accumulated over-life metal loss along the pipeline; prioritized regions for integrity validation.
ICPT-PM provides mitigation guidance for Production Operations
action to prevent corrosion initiation action plan to prevent growth of pre-existing corrosion damage.
ICPT-PM pin-points the most probable locations of corrosion and the severity of corrosion damage and accumulated over-life metal loss along the pipeline; prioritizes regions for integrity validation.
ICPT-PM provides mitigation guidance for Production Operations
action to prevent corrosion initiation action plan to prevent growth of pre-existing corrosion damage.
This 3-day course provides training to qualify for an initial electrical installation verification certificate. The course aims to prepare electricians and those from allied trades to inspect, test, and certify electrical installations. Course topics include regulations, inspection, testing equipment, testing procedures, and certification paperwork. Assessment includes a multiple choice exam and practical testing. Upon passing both assessments, candidates earn the City & Guilds 2392-10 qualification for fundamental inspection, testing, and initial verification of electrical installations.
This document discusses the various types of testing required for protection equipment, including:
- Type tests to prove the relay meets specifications and standards under abnormal power conditions.
- Routine factory production tests to check for defects during manufacturing.
- Commissioning tests to prove correct installation of a protection scheme before use.
- Periodic maintenance tests to identify equipment failures or degradation over time.
Electrical type tests are described in detail, including functional, rating, thermal withstand, burden, input, output, and insulation resistance tests. The purpose is to thoroughly evaluate performance and safety.
This document provides an overview of corrosion monitoring and assessment requirements for pipelines. It discusses regulatory requirements for external, internal, and atmospheric corrosion control. The document reviews various assessment methods including test point assessments, rectifier assessments, close interval surveys, direct current voltage gradients, bond assessments, isolation assessments, alternating current assessments, and visual inspections. It also discusses data collection and record keeping requirements. The presentation aims to help identify gaps in corrosion control programs and plan future assessments to achieve regulatory compliance.
The document lists several NACE pipeline standards related to corrosion control and prevention. It provides the standard title, description, and latest edition or expected publication date for each. The standards cover topics such as internal corrosion control, internal corrosion direct assessment for gas pipelines, stress corrosion cracking direct assessment, detection of microbiologically influenced corrosion, in-line pipeline inspections, external corrosion direct assessment, cathodic protection of underground pipelines, measurement techniques for cathodic protection criteria, internal corrosion direct assessment for liquid petroleum pipelines, close-interval potential surveys, steel-cased pipeline practices, techniques for evaluating external environmental corrosiveness, pipeline corrosion management, external corrosion confirmatory direct assessment, a report on the 100 mV cathodic polarization
SCT an Advanced Pipeline Integrity SolutionBrett Payton
The SCT Technique fills the gap in the armory of integrity engineers when assessing the condition of difficult to inspect pipelines and is being referred to as a "game changer" by many individuals in the industry.
Ensuring Precision and Performance Quality Control in Probe Card Manufacturin...Semi Probes Inc
Probe cards are used to test semiconductors and ensure quality. They contain probes that make electrical contact with semiconductor wafers during testing. Maintaining high quality is crucial in probe card manufacturing, which involves several stages: design, material selection, precision machining, assembly, calibration, and testing. Quality control occurs throughout using methods like visual inspection, electrical testing, reliability testing, process control, and failure analysis to check specifications are met. This helps prevent faulty chips and ensures reliable semiconductor testing results.
This document provides an overview of direct assessment (DA) and external corrosion direct assessment (ECDA) as alternatives to in-line inspection (ILI) or hydrotesting for assessing pipeline integrity when those methods are not feasible. It describes the multi-step ECDA process involving pre-assessment, indirect assessment using tools like CIS and DCVG, direct examination including excavation and testing, and post-assessment. The document outlines benefits and limitations of ECDA and emphasizes the importance of collecting and integrating data to identify corrosion threats and determine reassessment intervals.
Understand contents of ANSI C12.20-2010 for 0.2 and 0.5 Accuracy Class Meters.
Understand the Relationship of C12.20 to C12.1.
Understand ANSI C12.20 Changes Planned for 2015. Edition and ANSI C12.1 changes planned for 2014.
Understand new ANSI C12.29 for Field Testing and potential time frame.
Discuss – Will this affect how we test in the field?
The document provides findings from a study of India's national highway network conducted under the Indian Bridge Management System (IBMS). Key points include:
- IBMS was started in 2015 by the Ministry of Roads, Transport and Highways to inventory and inspect bridges. Field work was divided among 12 consultants.
- As of the study, over 300,000 bridges had been inventoried and over 200,000 inspected. Data analysis found most bridges were minor bridges, constructed over 50 years ago of concrete.
- Around 6,000 bridges were found to be structurally distressed or functionally inadequate. The findings recommend improving training for inspectors to ensure consistent, high-quality data collection and analysis.
This document summarizes the objectives and contents of an upcoming presentation on ANSI standards for electricity meter testing. The presentation will:
1) Explain the contents of ANSI C12.20-2010 for 0.2 and 0.5 accuracy class meters and its relationship to C12.1.
2) Discuss planned 2015 revisions to C12.20 and 2014 revisions to C12.1.
3) Introduce a new draft ANSI C12.29 standard focused on field testing and the timeline for its approval.
4) Consider whether the new standards will affect how meters are tested in the field.
Mohammad Mazid Hussain has over 13 years of experience in quality assurance and quality control in the petrochemical, refinery, and fertilizer industries. He has worked on projects in Saudi Arabia, Abu Dhabi, Qatar, and India as an E&I QA/QC engineer and inspector. His responsibilities included developing inspection test plans, conducting inspections, overseeing corrective actions, ensuring compliance with standards and specifications, and generating quality reports. He has expertise in instrumentation, electrical systems, cables, grounding, and commissioning.
The document discusses proposed changes to ANSI standards regarding field testing of electricity meters. It outlines:
1) Planned updates to ANSI C12.1 and C12.20 that will refer to a new ANSI C12.29 standard focused specifically on field testing procedures.
2) The new C12.29 standard is being drafted and will provide best practices for testing meters, instrument transformers, and auxiliary devices in the field.
3) The future of field testing is expected to involve more comprehensive checks of meters and installations beyond just accuracy, including software verification and tamper detection.
IRJET- A Case Study on Rehabilitation and Retrofitting of Cheetal Marriage Ac...IRJET Journal
The document presents a case study on the rehabilitation and retrofitting of Cheetal marriage accommodation buildings (P-1001 to P-1009 & P-1208 and P-1211) of the Indian army in Hissar. Non-destructive testing methods were used to evaluate the structural integrity and determine deterioration in the buildings. Test results showed high moisture levels, low pH levels indicating carbonation, and medium to doubtful quality of concrete based on ultrasonic pulse velocity tests. Visual inspections found cracks, spalling, efflorescence, dampness, and over 60% corrosion of reinforcement. The study aims to assess damage and apply suitable strengthening remedies to improve the structures.
In this paper study of Gas Tungsten Arc Welding
(GTAW) process used for Aerospace application, the
material used is Maraging steel (MDN250).The weld
defects are a major concern leading to rework, higher costs
and thus affecting the delivery schedule of the job. The
process starts with Welding of long seams and circular
seams in the job, and subsequently carrying out the NDT to
find any defects during welding. A number of defects are
being observed in the welding Process. Defects in welding
may be found out in two methods, i.e. by Radiographic
Tests and by Ultrasonic Tests. The paper deals with an
application of Six Sigma DMAIC (Define–MeasureAnalyze-Improve-Control)
methodology in an industry
which provides a framework to identify, quantify and
eliminate sources of variation in an operational process in
question, to optimize the operation variables. Six Sigma
improves the process performance of the critical
operational process, leading to better utilization of
resources, decreases variations & maintains consistent
quality of the process output.
This document summarizes a practical arc flash risk assessment strategy conducted on 174 high and low voltage switchboards at a mining site. The assessment included a physical condition assessment to determine the likelihood of arc faults occurring, and an arc flash evaluation to determine the consequences of arc faults. The results were combined into a risk matrix to prioritize upgrade and mitigation efforts. The assessment found 37 switchboards requiring replacement within 2 years and 58 requiring replacement within 5 years based on their poor condition and increased risk.
https://www.hitechpcba.com
PCBA testing refers to the test of electrical conductivity and input-output value based on PCBA board with electronic components.
PCBA SMT processing is very complicated and includes multiple important processes, such as PCB board manufacturing process, component procurement and inspection, SMT assembly, DIP, and PCBA testing. Among them, PCBA testing is the most critical quality control step in the entire PCBA processing process. The testing determines the final performance of the product.
This document discusses integrity management and external corrosion direct assessment (ECDA) over a 10 year period. It provides an overview of ECDA as a 4 step process including pre-assessment, indirect inspection, direct examination, and post assessment. Congress required pipeline operators to implement integrity management programs, including conducting baseline assessments using methods like ECDA, to help prevent pipeline failures and protect public safety. ECDA aims to locate potential corrosion issues to prioritize repairs and reassess pipelines over time. The document outlines each step of ECDA and emphasizes following the full process is important for ensuring pipeline integrity.
Similar to External Corrosion Direct Assessment (ECDA) (20)
CHINA’S GEO-ECONOMIC OUTREACH IN CENTRAL ASIAN COUNTRIES AND FUTURE PROSPECTjpsjournal1
The rivalry between prominent international actors for dominance over Central Asia's hydrocarbon
reserves and the ancient silk trade route, along with China's diplomatic endeavours in the area, has been
referred to as the "New Great Game." This research centres on the power struggle, considering
geopolitical, geostrategic, and geoeconomic variables. Topics including trade, political hegemony, oil
politics, and conventional and nontraditional security are all explored and explained by the researcher.
Using Mackinder's Heartland, Spykman Rimland, and Hegemonic Stability theories, examines China's role
in Central Asia. This study adheres to the empirical epistemological method and has taken care of
objectivity. This study analyze primary and secondary research documents critically to elaborate role of
china’s geo economic outreach in central Asian countries and its future prospect. China is thriving in trade,
pipeline politics, and winning states, according to this study, thanks to important instruments like the
Shanghai Cooperation Organisation and the Belt and Road Economic Initiative. According to this study,
China is seeing significant success in commerce, pipeline politics, and gaining influence on other
governments. This success may be attributed to the effective utilisation of key tools such as the Shanghai
Cooperation Organisation and the Belt and Road Economic Initiative.
International Conference on NLP, Artificial Intelligence, Machine Learning an...gerogepatton
International Conference on NLP, Artificial Intelligence, Machine Learning and Applications (NLAIM 2024) offers a premier global platform for exchanging insights and findings in the theory, methodology, and applications of NLP, Artificial Intelligence, Machine Learning, and their applications. The conference seeks substantial contributions across all key domains of NLP, Artificial Intelligence, Machine Learning, and their practical applications, aiming to foster both theoretical advancements and real-world implementations. With a focus on facilitating collaboration between researchers and practitioners from academia and industry, the conference serves as a nexus for sharing the latest developments in the field.
We have compiled the most important slides from each speaker's presentation. This year’s compilation, available for free, captures the key insights and contributions shared during the DfMAy 2024 conference.
Electric vehicle and photovoltaic advanced roles in enhancing the financial p...IJECEIAES
Climate change's impact on the planet forced the United Nations and governments to promote green energies and electric transportation. The deployments of photovoltaic (PV) and electric vehicle (EV) systems gained stronger momentum due to their numerous advantages over fossil fuel types. The advantages go beyond sustainability to reach financial support and stability. The work in this paper introduces the hybrid system between PV and EV to support industrial and commercial plants. This paper covers the theoretical framework of the proposed hybrid system including the required equation to complete the cost analysis when PV and EV are present. In addition, the proposed design diagram which sets the priorities and requirements of the system is presented. The proposed approach allows setup to advance their power stability, especially during power outages. The presented information supports researchers and plant owners to complete the necessary analysis while promoting the deployment of clean energy. The result of a case study that represents a dairy milk farmer supports the theoretical works and highlights its advanced benefits to existing plants. The short return on investment of the proposed approach supports the paper's novelty approach for the sustainable electrical system. In addition, the proposed system allows for an isolated power setup without the need for a transmission line which enhances the safety of the electrical network
6th International Conference on Machine Learning & Applications (CMLA 2024)ClaraZara1
6th International Conference on Machine Learning & Applications (CMLA 2024) will provide an excellent international forum for sharing knowledge and results in theory, methodology and applications of on Machine Learning & Applications.
Introduction- e - waste – definition - sources of e-waste– hazardous substances in e-waste - effects of e-waste on environment and human health- need for e-waste management– e-waste handling rules - waste minimization techniques for managing e-waste – recycling of e-waste - disposal treatment methods of e- waste – mechanism of extraction of precious metal from leaching solution-global Scenario of E-waste – E-waste in India- case studies.
A SYSTEMATIC RISK ASSESSMENT APPROACH FOR SECURING THE SMART IRRIGATION SYSTEMSIJNSA Journal
The smart irrigation system represents an innovative approach to optimize water usage in agricultural and landscaping practices. The integration of cutting-edge technologies, including sensors, actuators, and data analysis, empowers this system to provide accurate monitoring and control of irrigation processes by leveraging real-time environmental conditions. The main objective of a smart irrigation system is to optimize water efficiency, minimize expenses, and foster the adoption of sustainable water management methods. This paper conducts a systematic risk assessment by exploring the key components/assets and their functionalities in the smart irrigation system. The crucial role of sensors in gathering data on soil moisture, weather patterns, and plant well-being is emphasized in this system. These sensors enable intelligent decision-making in irrigation scheduling and water distribution, leading to enhanced water efficiency and sustainable water management practices. Actuators enable automated control of irrigation devices, ensuring precise and targeted water delivery to plants. Additionally, the paper addresses the potential threat and vulnerabilities associated with smart irrigation systems. It discusses limitations of the system, such as power constraints and computational capabilities, and calculates the potential security risks. The paper suggests possible risk treatment methods for effective secure system operation. In conclusion, the paper emphasizes the significant benefits of implementing smart irrigation systems, including improved water conservation, increased crop yield, and reduced environmental impact. Additionally, based on the security analysis conducted, the paper recommends the implementation of countermeasures and security approaches to address vulnerabilities and ensure the integrity and reliability of the system. By incorporating these measures, smart irrigation technology can revolutionize water management practices in agriculture, promoting sustainability, resource efficiency, and safeguarding against potential security threats.
KuberTENes Birthday Bash Guadalajara - K8sGPT first impressionsVictor Morales
K8sGPT is a tool that analyzes and diagnoses Kubernetes clusters. This presentation was used to share the requirements and dependencies to deploy K8sGPT in a local environment.
2. Matthew Myers, Manager of Integrity & Corrosion
TODAY’S SPEAKER
Matt Myers is the Manager of Asset Integrity & Corrosion
at Audubon Field Solutions. He has over 8 years of
experience in engineering, design, construction,
operation and maintenance of pipeline systems for
natural gas (192), LNG (193), and hazardous liquids (195)
systems. NACE certified, Matt is a technical and
operational expert in pipeline and asset integrity, external
corrosion, internal corrosion, and cathodic protection. He
holds a BS degree in Electrical Engineering from the Texas
A&M University and is currently pursuing an MBA from
Oklahoma State University.

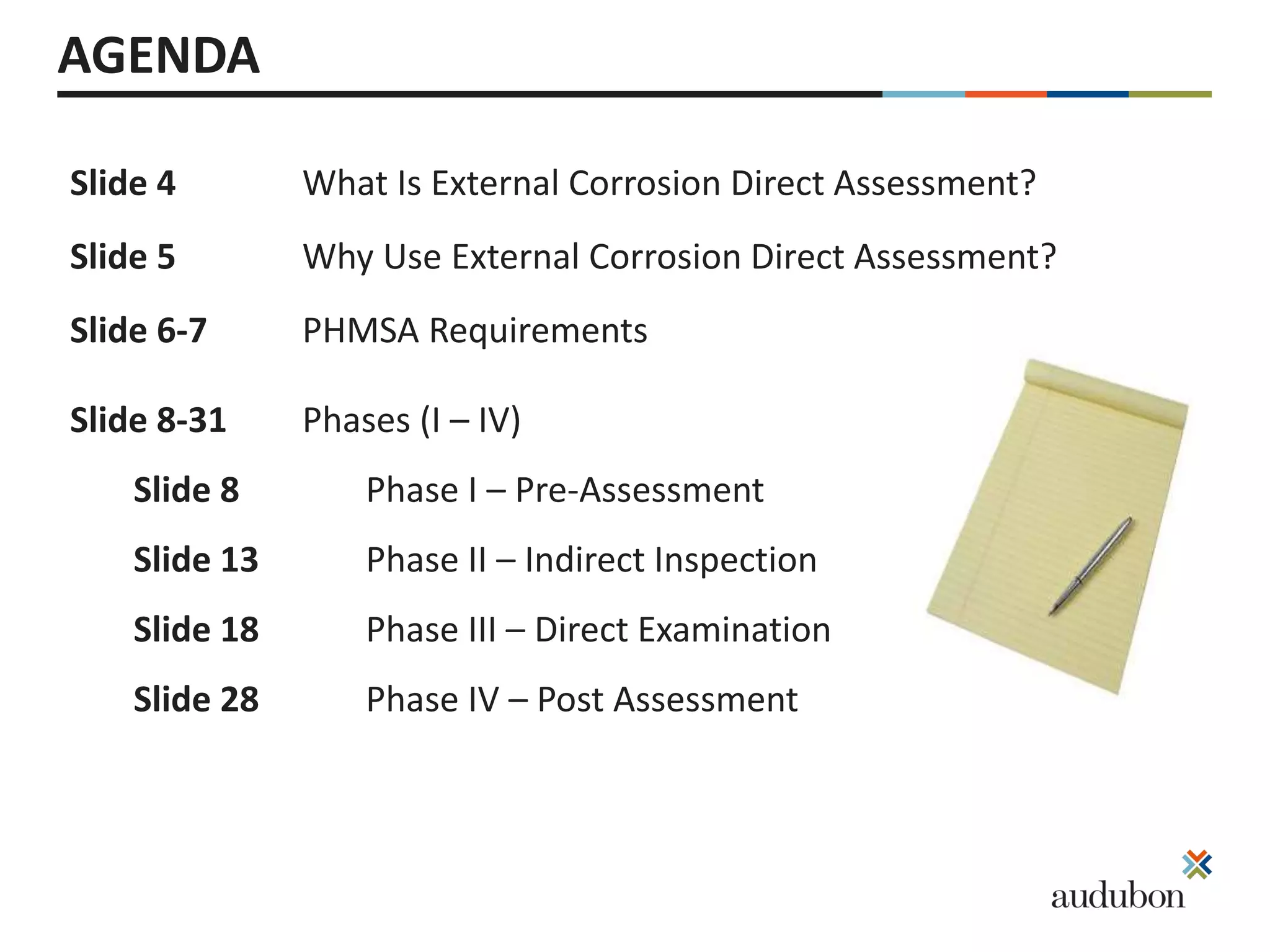

3. AGENDA
Slide 4 What Is External Corrosion Direct Assessment?
Slide 5 Why Use External Corrosion Direct Assessment?
Slide 6-7 PHMSA Requirements
Slide 8-31
Slide 8
Slide 13
Slide 18
Slide 28
Phases (I – IV)
Phase I – Pre-Assessment
Phase II – Indirect Inspection
Phase III – Direct Examination
Phase IV – Post Assessment
4. External Corrosion Direct Assessment
WHAT IS ECDA?
NACE Standard SP0502
ECDA was developed as a process for improving pipeline safety. Its primary purpose is
preventing future external corrosion damage.
ECDA is a continuous improvement process. Through successive applications, ECDA should
identify and address locations at which corrosion activity has occurred, is occurring, or may
occur.

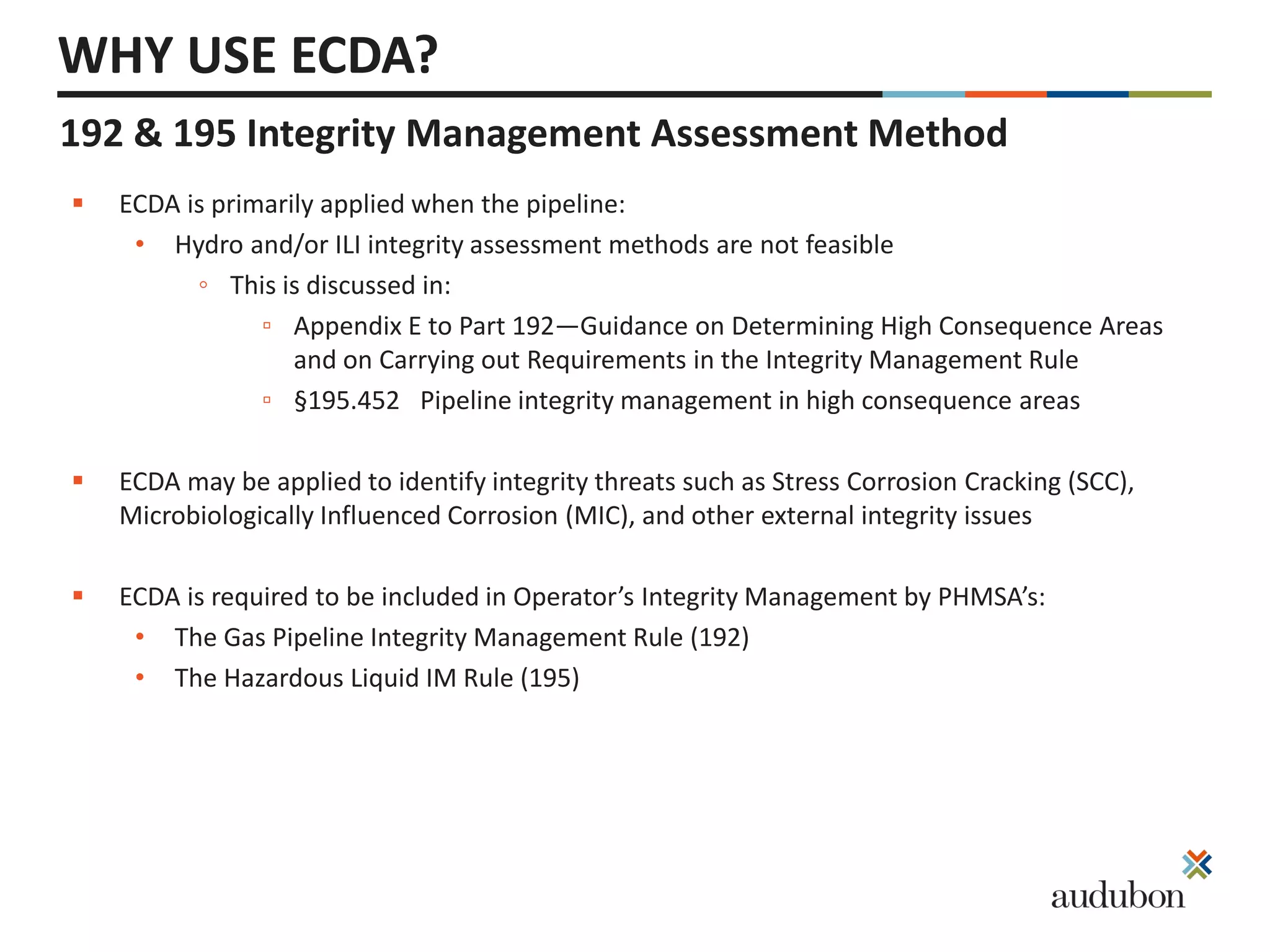

5. ECDA is primarily applied when the pipeline:
• Hydro and/or ILI integrity assessment methods are not feasible
◦ This is discussed in:
▫ Appendix E to Part 192—Guidance on Determining High Consequence Areas
and on Carrying out Requirements in the Integrity Management Rule
▫ §195.452 Pipeline integrity management in high consequence areas
ECDA may be applied to identify integrity threats such as Stress Corrosion Cracking (SCC),
Microbiologically Influenced Corrosion (MIC), and other external integrity issues
ECDA is required to be included in Operator’s Integrity Management by PHMSA’s:
• The Gas Pipeline Integrity Management Rule (192)
• The Hazardous Liquid IM Rule (195)
WHY USE ECDA?
192 & 195 Integrity Management Assessment Method
6. PART 192—Transportation of Natural and Other Gas by Pipeline: Minimum Federal Safety
Standards
§192.911 What are the elements of an integrity management program?
• (d) A direct assessment plan, if applicable, meeting the requirements of §192.923, and
depending on the threat assessed, of §192.925, 192.927, or 192.929
§192.939 What are the required reassessment intervals?
• (a) – Assessment Intervals – 7 years
• (a) & (b) – ECDA approved method
§192.925 What are the requirements for using External Corrosion Direct Assessment (ECDA)?
• ECDA Methodology; References directly NACE SP0502
PART 195—Transportation of Hazardous Liquids by Pipeline
§195.452 Pipeline integrity management in high consequence areas.
• (j)(3) – Assessment Intervals – 5 years
• (j)(5)(iii) – ECDA approved method
§195.588 What standards apply to direct assessment?
• ECDA Methodology; References directly NACE SP0502
PHMSA REQUIREMENTS

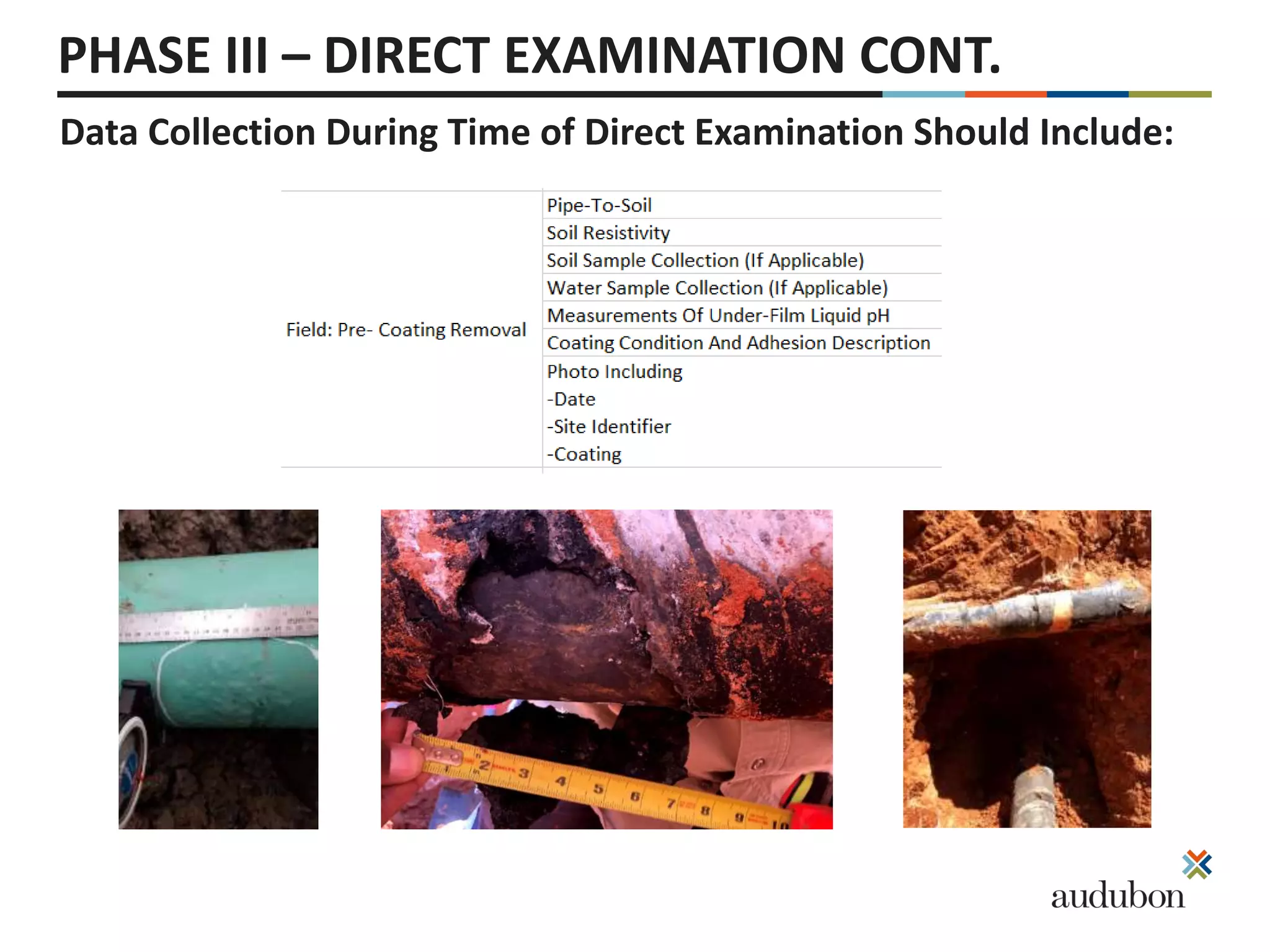

7. The Pre-Assessment phase includes:
PHASE I – PRE-ASSESSMENT
The collection of historical and current pipeline
data to determine if ECDA is feasible
• Consideration includes:
◦ Construction Records
◦ Operating and Maintenance Records
◦ Alignment Sheets
◦ Corrosion Records
◦ Aboveground Inspection Records
◦ Prior Inspection Reports
Defining of ECDA regions
• NACE Table 1: ECDA Data Elements
Selection of indirect survey tools
8. PHASE I – PRE-ASSESSMENT CONT.

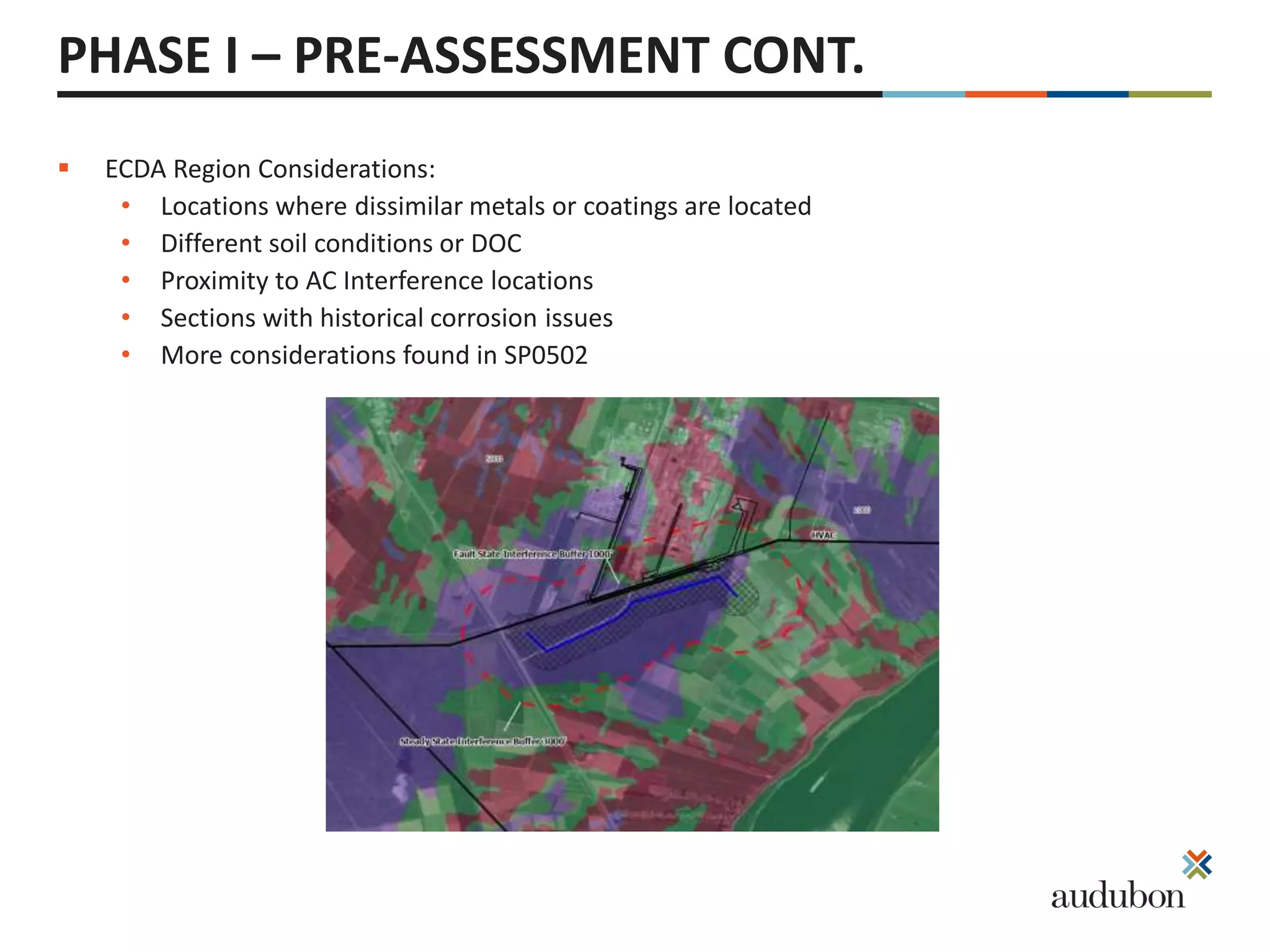

ECDA Region Considerations:
• Locations where dissimilar metals or coatings are located
• Different soil conditions or DOC
• Proximity to AC Interference locations
• Sections with historical corrosion issues
• More considerations found in SP0502

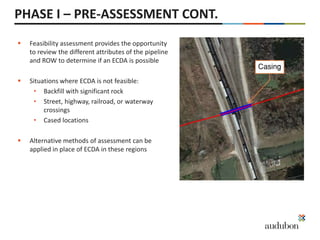

9. PHASE I – PRE-ASSESSMENT CONT.
Feasibility assessment provides the opportunity
to review the different attributes of the pipeline
and ROW to determine if an ECDA is possible
Situations where ECDA is not feasible:
• Backfill with significant rock
• Street, highway, railroad, or waterway
crossings
• Cased locations
Alternative methods of assessment can be
applied in place of ECDA in these regions

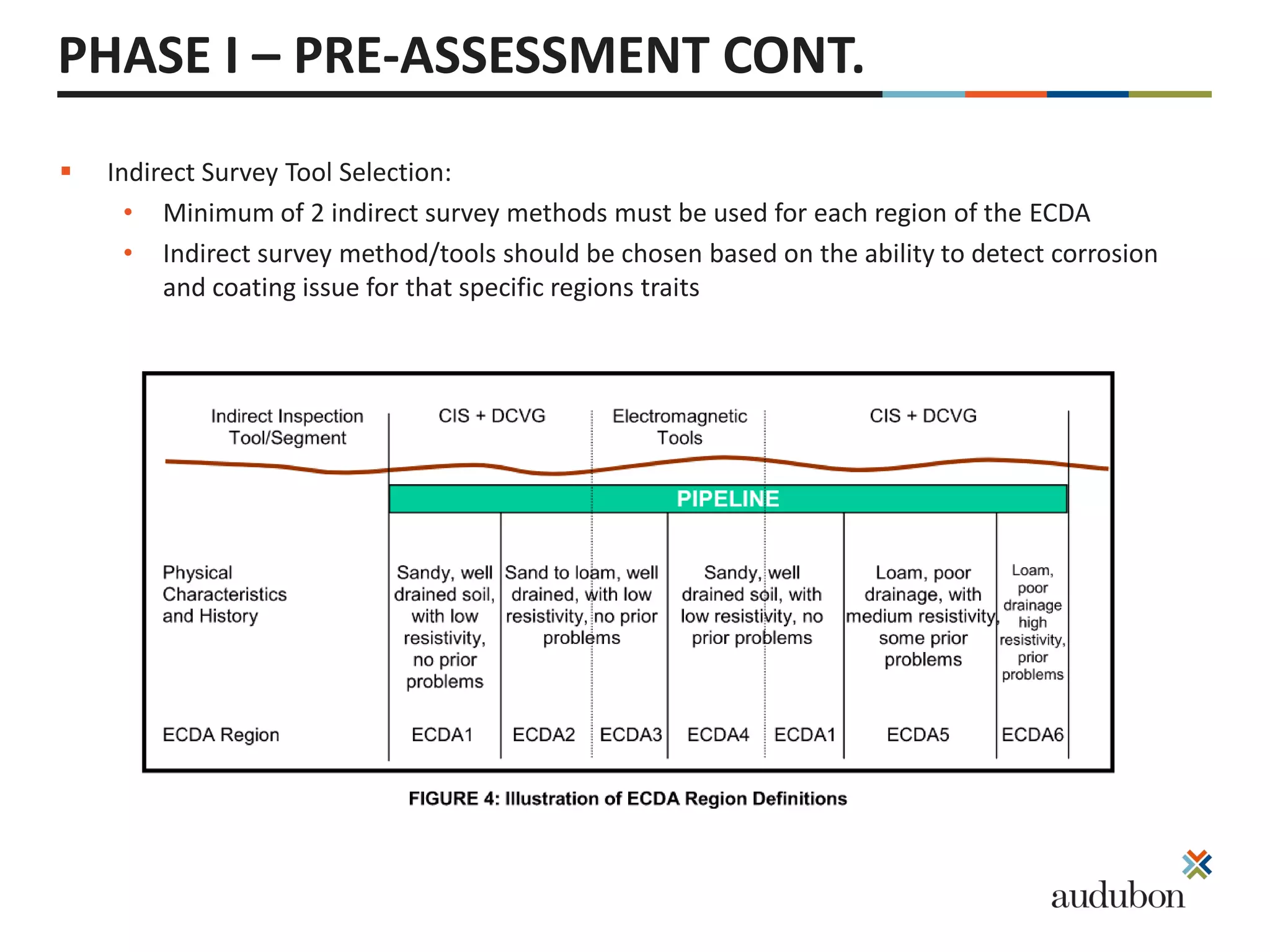

10. Indirect Survey Tool Selection:
• Minimum of 2 indirect survey methods must be used for each region of the ECDA
• Indirect survey method/tools should be chosen based on the ability to detect corrosion
and coating issue for that specific regions traits
PHASE I – PRE-ASSESSMENT CONT.
11. TABLE 2: ECDA TOOL SELECTION MATRIX
1= Applicable: Small coating holidays (isolated and typically <600 mm2 [1 in.2]) and conditions that do not cause
fluctuations in CP potentials under normal operating conditions.
2= Applicable: Large coating holidays (isolated and continuous) or conditions that cause fluctuations in CP
potentials under normal operating conditions.
3= Not Applicable: Not applicate to this tool or not applicable to this tool without additional considerations.
NACE SP0502 Table 2: ECDA Tool Selection Matrix
12. PHASE II – INDIRECT SURVEY
Two (2) Indirect Survey Methods/Tools per ECDA region
Indirect surveys should be completed as close together (in time) as practical
Care should be taken to ensure alignment/GPS of surveys are accurate
Align indirect assessment data
Pre-approved criteria should be used to classify the severity of the indications
13. PHASE II – INDIRECT SURVEY CONT.

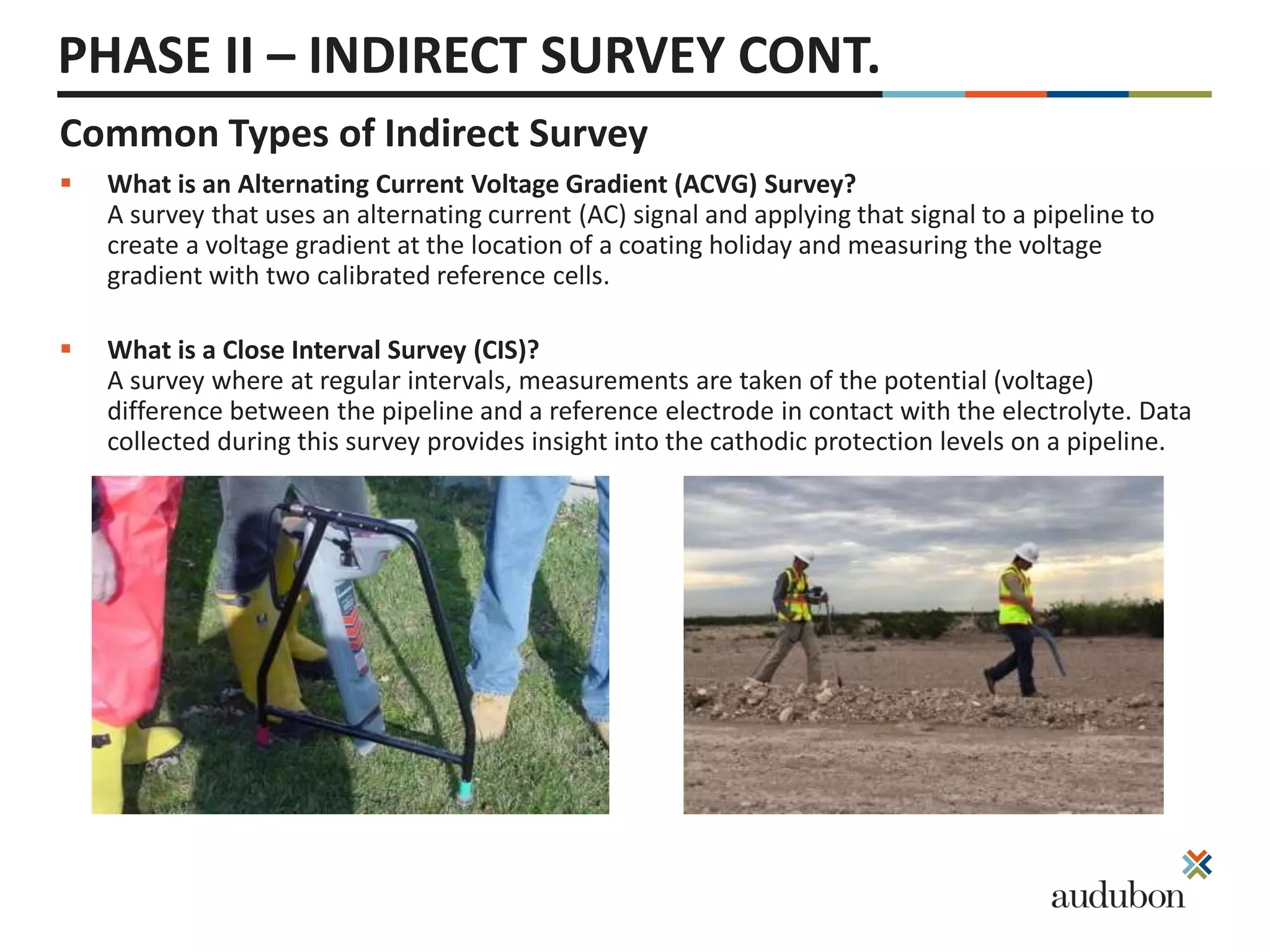

Common Types of Indirect Survey
What is an Alternating Current Voltage Gradient (ACVG) Survey?
A survey that uses an alternating current (AC) signal and applying that signal to a pipeline to
create a voltage gradient at the location of a coating holiday and measuring the voltage
gradient with two calibrated reference cells.
What is a Close Interval Survey (CIS)?
A survey where at regular intervals, measurements are taken of the potential (voltage)
difference between the pipeline and a reference electrode in contact with the electrolyte. Data
collected during this survey provides insight into the cathodic protection levels on a pipeline.
14. PHASE II – INDIRECT SURVEY CONT.
What is a Direct Current Voltage Gradient (DCVG) Survey?

A survey that uses a direct current (DC) signal and applying that signal to a pipeline to create a
voltage gradient at the location of a coating holiday and measuring the voltage gradient with
two calibrated reference cells.
What is a Pipeline Current Mapper (PCM)?
A device used to perform an AC current attenuation survey to qualitatively rank coating quality
and highlight pipeline locations with the most significant coating holidays (defects).
15. PHASE II – INDIRECT SURVEY CONT.
Classifications:
• Severe – Indications that the pipeline operator considers as having the highest likelihood
or corrosion activity.
• Moderate – Indications that the pipeline operator considers as having possible corrosion
activity.
• Minor – Indication that the pipeline operator considers inactive or as having the lowest
likelihood of corrosion activity.
PHMSA gives no guidance on what exactly constitutes Minor, Moderate, or Severe.
NACE SP0502
16. PHASE II – INDIRECT SURVEY CONT.
Audubon Classifications
17. PHASE III – DIRECT EXAMINATION

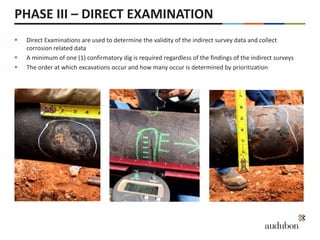

Direct Examinations are used to determine the validity of the indirect survey data and collect
corrosion related data
A minimum of one (1) confirmatory dig is required regardless of the findings of the indirect surveys
The order at which excavations occur and how many occur is determined by prioritization
19. PHASE III – DIRECT EXAMINATION CONT.

Audubon Example of an ACVG and CIS Prioritization Matrix Table
20. PHASE III – DIRECT EXAMINATION CONT.

ECDA Effectiveness?
ECDA effectiveness is part of the Phase IV Post-Assessment but is used in the Direct Examinations
NACE STANDARDS SP0502
6.4.2.1 - For initial ECDA applications, at least two additional direct examinations are required
for process validation. The direct examinations shall be conducted at randomly selected
locations, one of which is categorized as scheduled (or monitored if no scheduled indications
exist) and one in an area where no indication was detected.
6.4.2.1 – If conditions that are more severe than determined during the ECDA process (i.e., that
result in a reassessment interval less than determined during the ECDA process) are detected,
the process shall be reevaluated and repeated or an alternative integrity assessment method
used.
21. PHASE III – DIRECT EXAMINATION CONT.
Initial ECDA Required Direct Examinations
Table Based on NACE SP0502 5.10
22. PHASE III – DIRECT EXAMINATION CONT.

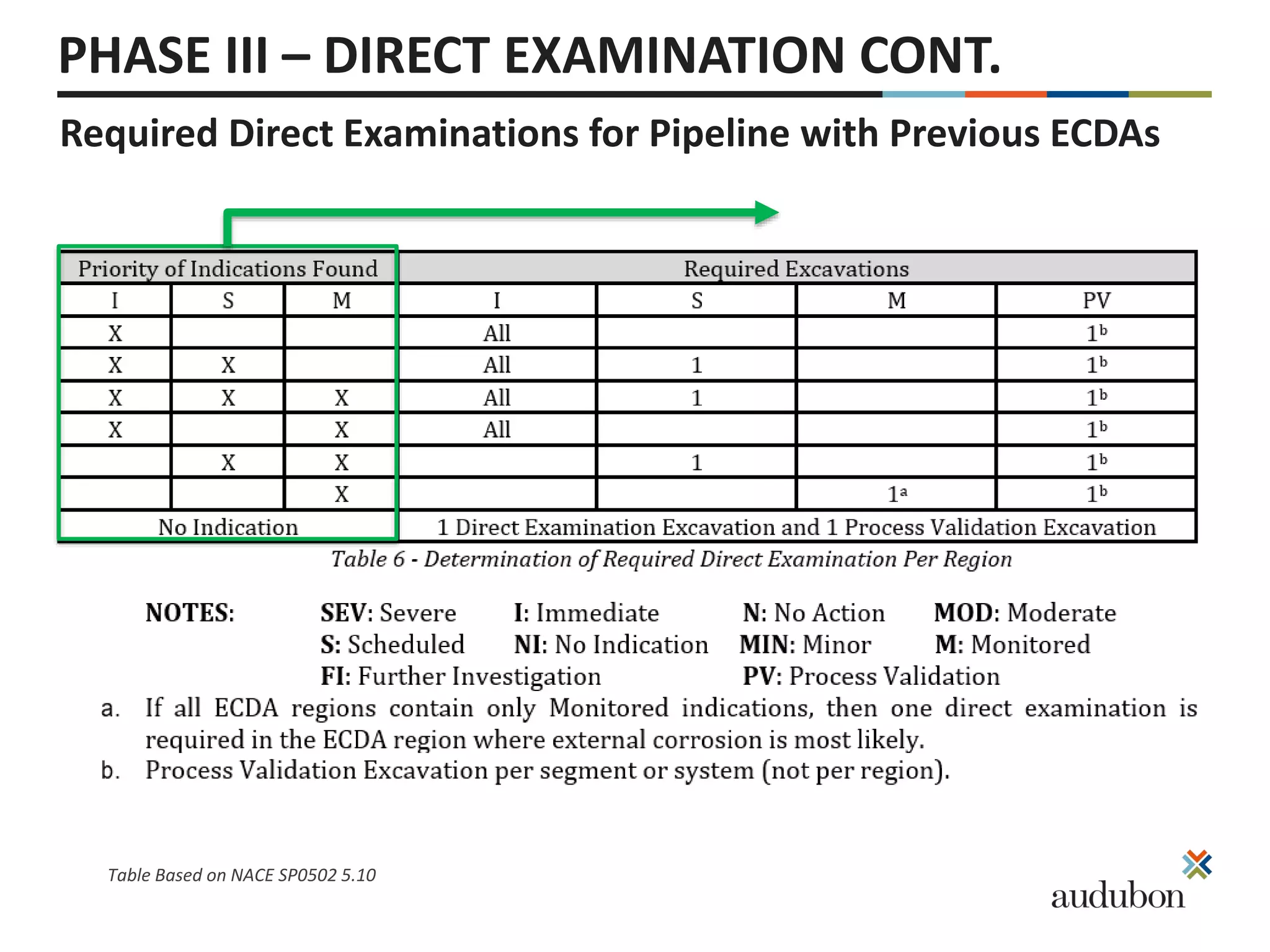

Required Direct Examinations for Pipeline with Previous ECDAs
Table Based on NACE SP0502 5.10
23. PHASE III – DIRECT EXAMINATION CONT.

Data Collection During Time of Direct Examination Should Include:
24. PHASE III – DIRECT EXAMINATION CONT.
Data Collection During Time of Direct Examination Should Include:
25. PHASE III – DIRECT EXAMINATION CONT.
Data Collection During Time of Direct Examination Should Include:
26. PHASE III – DIRECT EXAMINATION CONT.
Remaining Strength Evaluation

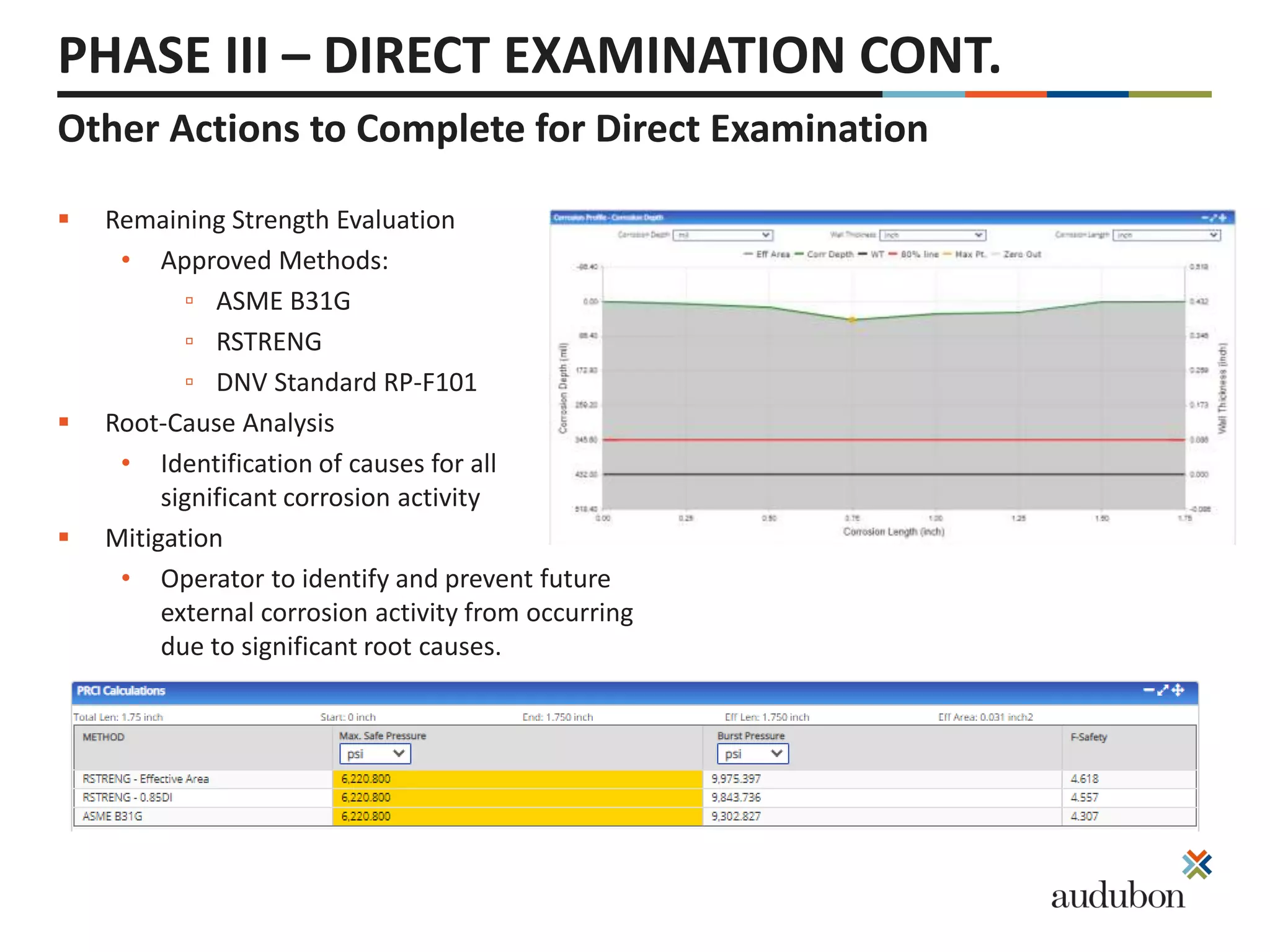

• Approved Methods:
▫ ASME B31G
▫ RSTRENG
▫ DNV Standard RP-F101
Root-Cause Analysis
• Identification of causes for all
significant corrosion activity
Mitigation
• Operator to identify and prevent future
external corrosion activity from occurring
due to significant root causes.
Other Actions to Complete for Direct Examination
27. Post-Assessment Steps
PHASE IV – POST ASSESSMENT
STEP 1

Remaining Life Calculations
STEP 4
Feedback and Continuous
Improvement
STEP 3
Assessment of ECDA Effectiveness
(as discussed in phase III)
STEP 2
Definition of Reassessment
Intervals
28. PHASE IV – POST ASSESSMENT CONT.
Remaining Life Calculations
• Only done if corrosion defects
are found.
Calculations Include:
• Remaining Life
• Corrosion Growth Rate
Remaining Life Calculation Method:
29. PHASE IV – POST ASSESSMENT CONT.
NACE STANDARD SP0502 Reassessment Intervals
6.3.1 – When corrosion defects are found during the direct examinations, the maximum
reassessment interval for each ECDA region shall be taken as one-half the calculated
remaining life. The maximum reassessment interval may be further limited by documents
such as ASME B31.4 and ASME B31.8.
PART 192—Transportation Of Natural And Other Gas By Pipeline: Minimum Federal Safety
Standards
• §192.939 What are the required reassessment intervals?
◦ (a) – Assessment Intervals – 7 years
PART 195—Transportation Of Hazardous Liquids By Pipeline
• §195.452 Pipeline integrity management in high consequence areas.
◦ (j)(3) – Assessment Intervals – 5 years
Reassessment Intervals
30. PHASE IV – POST ASSESSMENT CONT.

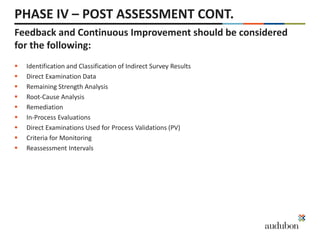

Identification and Classification of Indirect Survey Results
Direct Examination Data
Remaining Strength Analysis
Root-Cause Analysis
Remediation
In-Process Evaluations
Direct Examinations Used for Process Validations (PV)
Criteria for Monitoring
Reassessment Intervals
Feedback and Continuous Improvement should be considered
for the following:
31. D: C:
Manager of Integrity and Corrosion
mmyers@auduboncompanies.com
918-514-5846
Matthew Myers
918-986-6139
auduboncompanies.com
192 GAS
It is directly reference in the 192 Integrity Management requirements
Assessment Intervals – Maximum 7 years without prior approval by PHMSA
ECDA is an approved method for direct assessment by PHMSA
195 LIQUIDS
It is directly reference in the 195 Integrity Management requirements
Assessment Intervals – Maximum 5 years without prior approval by PHMSA
ECDA is an approved method for direct assessment by PHMSA
“NACE Table 1: ECDA Data Elements” Lists different pipeline elements how that element might affect an ECDA region and/or how you could possibly create a region from that element.
FBE vs FBE/ARO vs Coal Tar vs Shrink Sleeves…..etc
Normal DOC vs a bore or river crossing
AC Interference ROW
Historical leak areas or areas where direct assessment or cut outs have occurred.
Alternative Methods might include “Other Technologies”. Guided Wave UT (GWUT) is a possible method but requires approval from PHMSA.
Guidelines for Integrity Assessment of Cased Pipe for Gas Transmission Pipelines in HCAs
https://www.phmsa.dot.gov/pipeline/gas-transmission-integrity-management/guidelines-integrity-assessment-cased-pipe-gas-transmission-pipelines-in-hcas
NACA SP0502 previously gave guidance but that guidance was removed.
SP0502 5.1.3 Minimum 1 Dig
Example given by SP0502
Audubon collects data based on API 1163 and SP0502
Insures thoroughness
