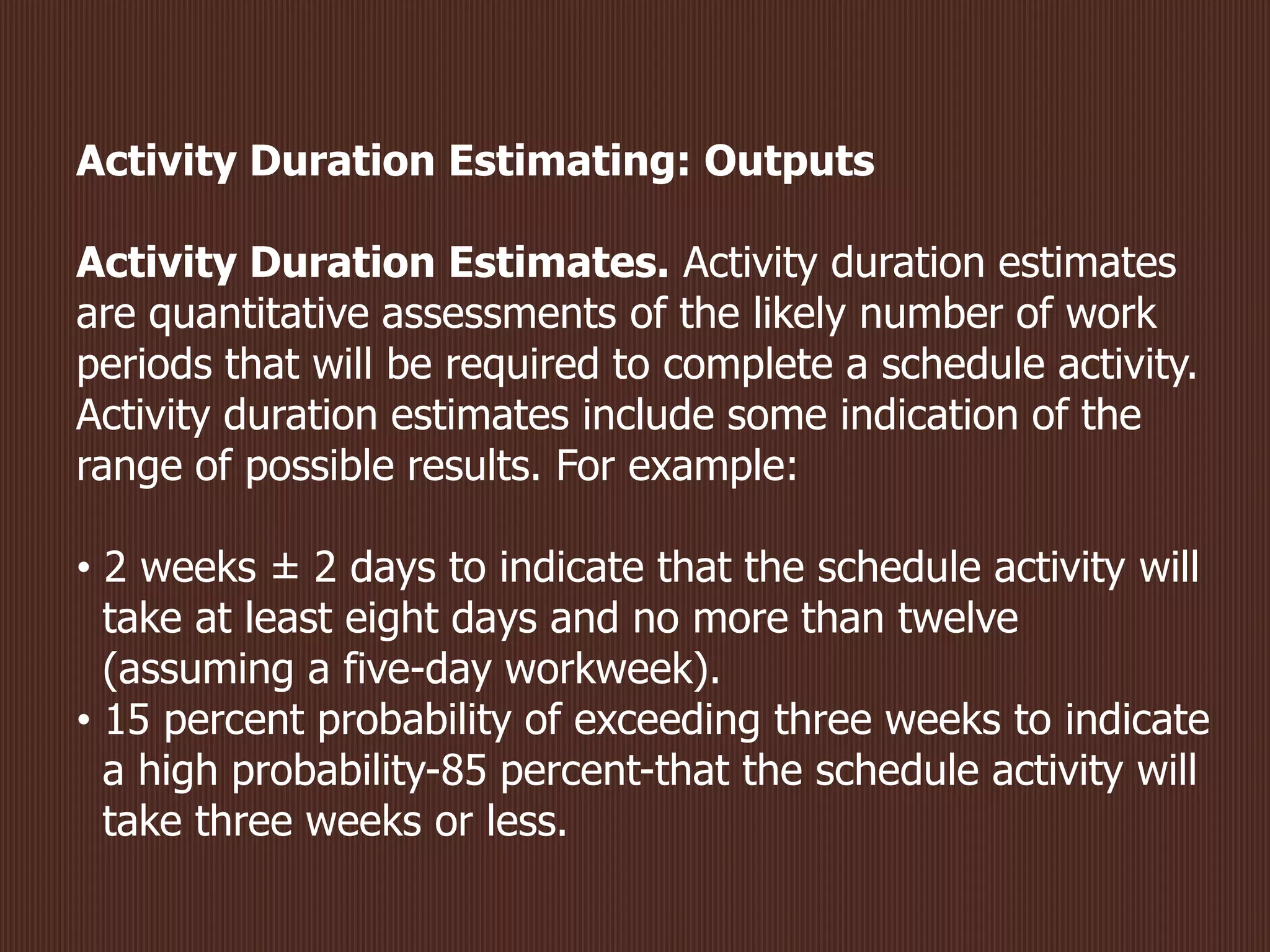

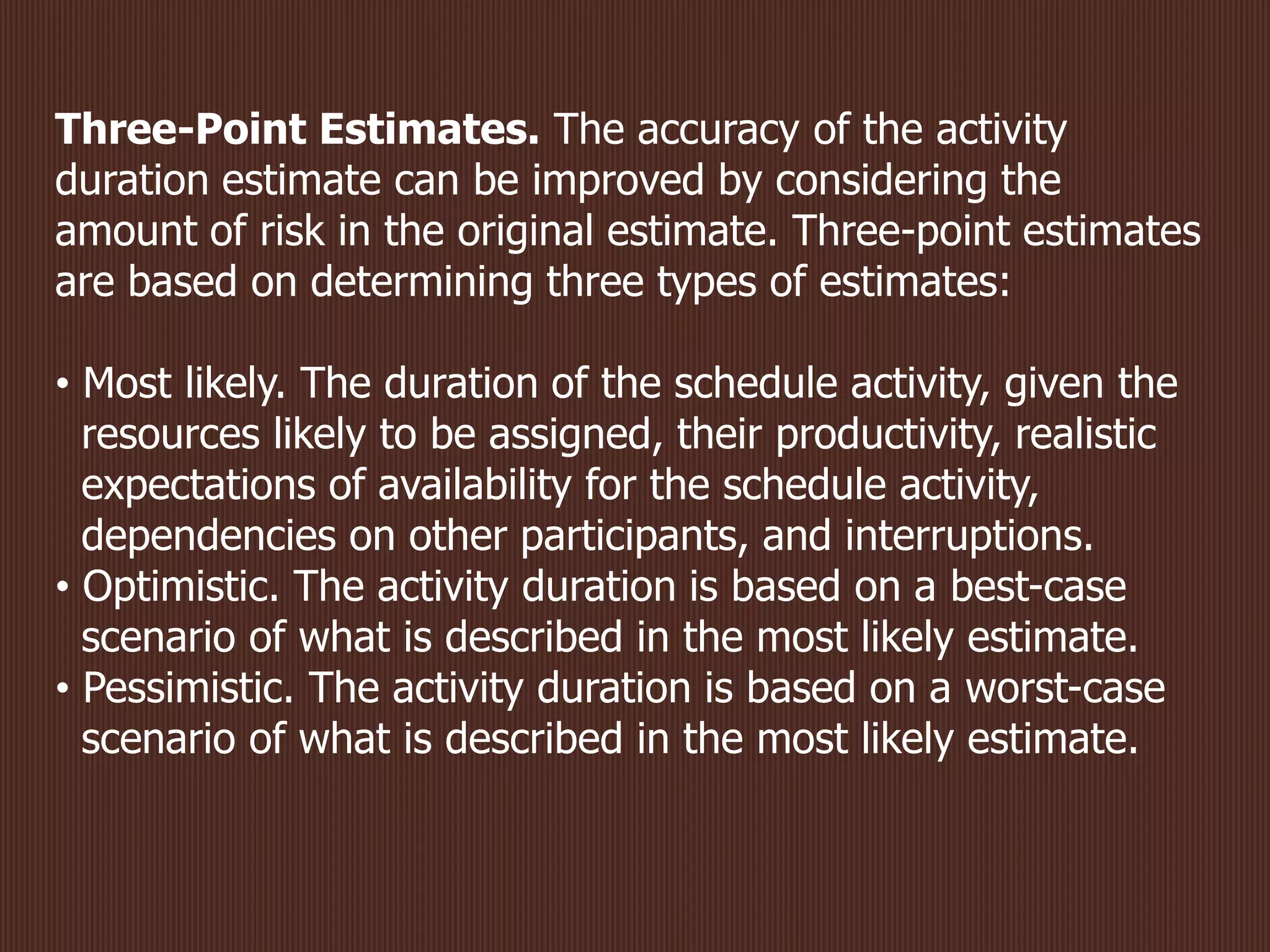

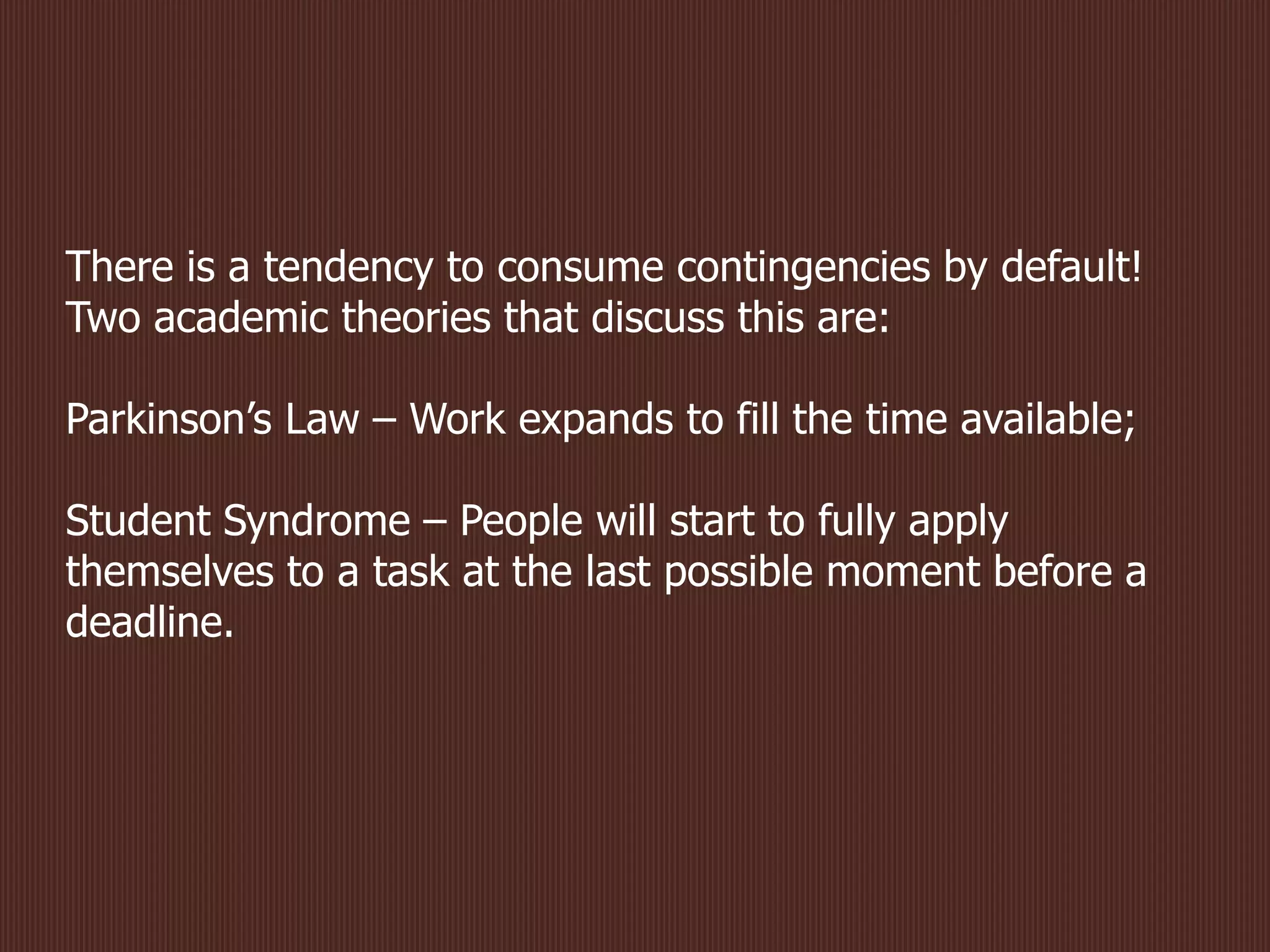

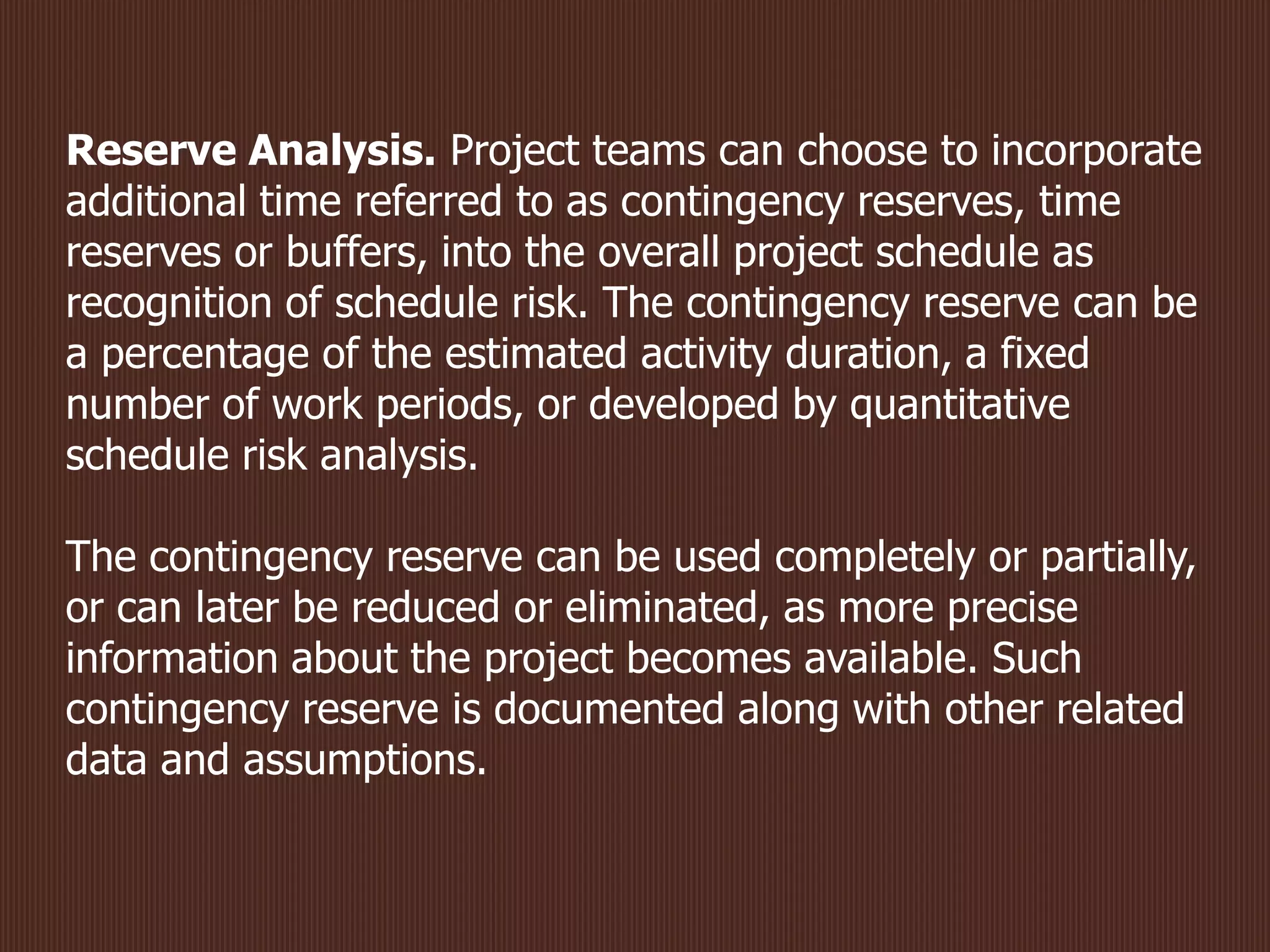

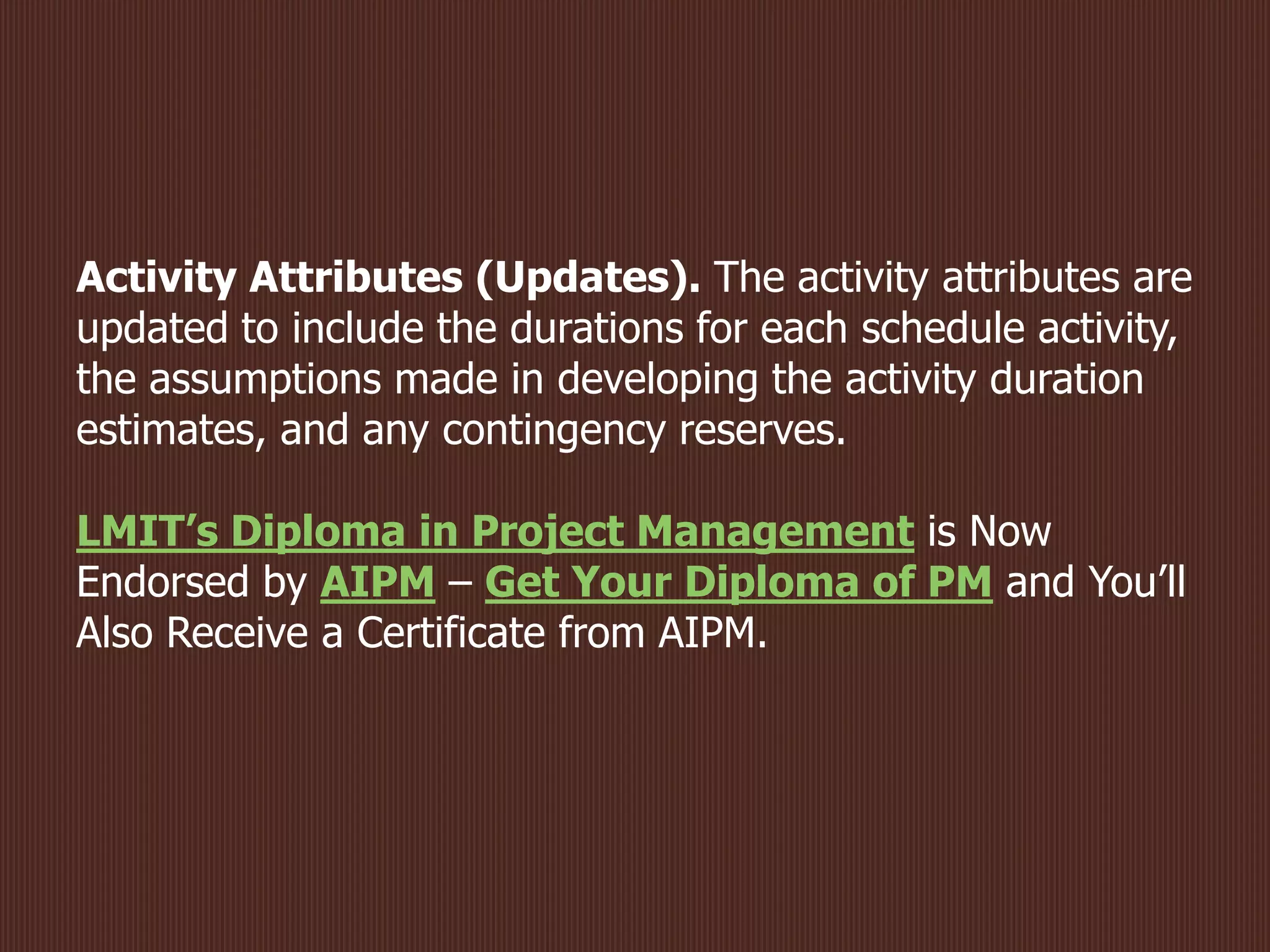

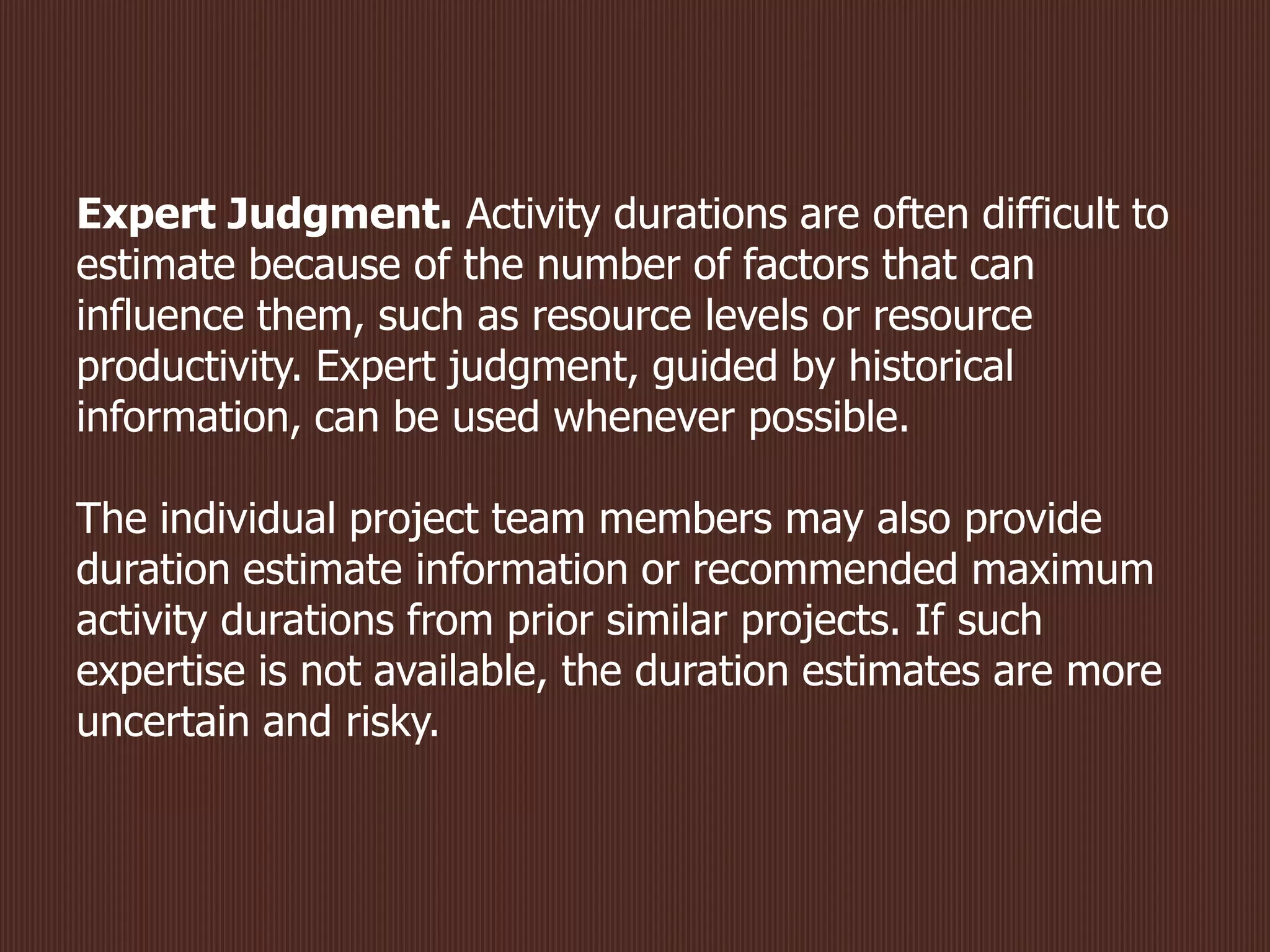

This document discusses different techniques for estimating activity durations in project management, including expert judgement, analogous estimating, parametric estimating, three-point estimates, and reserve analysis. It notes that activity duration estimates should include some indication of possible variance, and that the outputs of duration estimating include updated activity attributes and assumptions in the project schedule.
