June 3, 2014
Hydrocarbon Value Chain Optimization
What Leading Companies Are Getting Right
“Execution Excellence”
2
What keeps the c-suite awake at night?
Stakeholder
demands
Return on
assets
Complexity
CEO CFO COO
Copyright © 2014 Accenture All rights reserved.
Increased
Internal &
External
Complexity
Poor
Execution
Loss of
Control
Poor
Business
Results
Reactive
and Poor
Decisions
Vicious Cycle
3
Increasing business challenges and complexity
Leading companies break out of the vicious cycle with effective
execution excellence
Copyright © 2014 Accenture All rights reserved.
4
7 key dimensions leading companies are getting right
Value
chain
execution
excellence
Technology enablement
Operational readiness
Operational excellence
Commercial excellence
Organizational effectiveness
Strategy deployment
Strategic challenges
CEO
Financial challenges
CFO
Operational challenges
COO
p
Business performance
management
Copyright © 2014 Accenture All rights reserved.
5
Strategy deployment
• Establish true north – WHY?
• Define strategic clear goals and objectives
• Alignment top to bottom
• Limited organizational boundaries and
bureaucratic constraints
• Execute strategy more consistently and
reliably than competition
Without strategy, execution is aimless
Without execution, strategy is useless
=
Copyright © 2014 Accenture All rights reserved.
6
Value chain convergence
• Move toward a more data driven and efficient organization
• Leverage business intelligence and data visualization
• Efficient and effective flow of physical goods and information
• Flexibility to quickly adopt and adapt to changes in the business environment
• Customize solutions for different segments of customers and requirements
Digitalization is converging traditional value chains
Financial
supply chain
Physical
supply chain
Information
value chain
Talent
Supply chain
Social media
Mobility
Analytics /
big data
Cloud
Value chain
Digital technologies
Business
Digital supply
network
Copyright © 2014 Accenture All rights reserved.
7

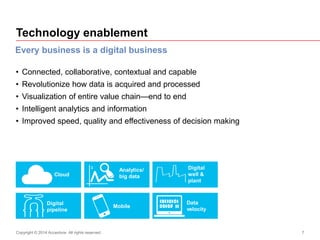

Technology enablement
• Connected, collaborative, contextual and capable
• Revolutionize how data is acquired and processed
• Visualization of entire value chain—end to end
• Intelligent analytics and information
• Improved speed, quality and effectiveness of decision making
Every business is a digital business
Analytics/
big dataCloud
Data
velocity
Mobile
Digital
well &
plant
Digital
pipeline
Copyright © 2014 Accenture All rights reserved.
8

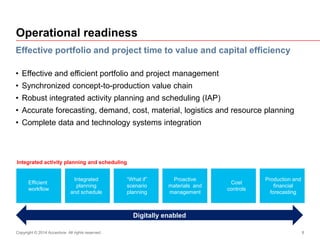

Operational readiness
• Effective and efficient portfolio and project management
• Synchronized concept-to-production value chain
• Robust integrated activity planning and scheduling (IAP)
• Accurate forecasting, demand, cost, material, logistics and resource planning
• Complete data and technology systems integration
Efficient
workflow
Effective portfolio and project time to value and capital efficiency
Integrated activity planning and scheduling
Digitally enabled
Integrated
planning
and schedule
“What if”
scenario
planning
Proactive
materials and
management
Production and
financial
forecasting
Cost
controls
Copyright © 2014 Accenture All rights reserved.
Asset lifecycle management
• Integrated handover plan
• Effective asset data handover and integrity
• Documented key work flows to manage production
• Complete operational playbooks and training
• Integration of project and manufacturing technology systems
Effectively bridging the transition from readiness to excellence
Pre-
Development
Development Production Maturity
Operational
Readiness
Operational
Excellence
Lifecycle Management
Time
ProductionRate
X
Copyright © 2014 Accenture All rights reserved. 9
10
Operational excellence
• State of alignment for achieving business and operational strategies
• Holistic framework approach to business improvement
• Focused, simplified and constantly attacking complexity
• Corporate culture committed to continuous improvement
• Achieved by design and not by coincidence
• Sustained with the right attitude, the right mindset and the right competencies
Strengthen economic and competitive position of the business
Reducing
cycle-time for
project
delivery
Reducing
production and
process losses
Reducing
variation in
production
Sustainably
lowering
unit costs
Maximizing value
delivered from
portfolio
Effectively
managing
production
decline
Digitally enabled
Copyright © 2014 Accenture All rights reserved.
11
Integrated operations
• Full value chain visibility
• Relocation of staff from remote sites
• Coordination, collaboration and decision making
• Technology enabled
• Talent recruitment and retention
• Health and safety risk reduction
Resources and information enabling operational excellence
Digitally enabled
Real-time
process
visualization
Key performance
Indicators and
dashboards
Collaboration
Copyright © 2014 Accenture All rights reserved.
Integrated
operations‘
center
Predictive
analytics
Condition
assessment
12
Asset optimization
• Overall strategic and operational risk framework
• Advanced monitoring and prediction of asset performance
• Seamless connection of asset performance to maintenance execution
• Proactively managing supply chain and resources
• Integrated technology systems with quality data
Holistic approach to strategic asset optimization aligned to
business objectives
Digitally enabled
Asset data
quality &
management,
integration,
CMMS /
EAM systems
MRO sourcing
and
procurement,
network
inventory
optimization
MRO inventory
management
and movement
Maintenance
execution
planning,
scheduling
T/A, mgmt.
systems and
KPI reporting
Asset /
reliability /
maintenance
strategy
Predictive
analytics
PM/PDM/CBM
routines
Critical
equipment
strategies,
operational
risk
Asset
benchmarking
Copyright © 2014 Accenture All rights reserved.
13
Commercial excellence
• End-to-end sales and operations planning and execution
• Near real-time scenario generation and access to operational information
• Full value chain financial, physical asset and inventory visibility
• Increased responsiveness to the market, internal and external customers
• Integration of applications, systems and refinery optimization models
Closing the gap between planned and actual performance to
improve margins
Digitally enabled
Copyright © 2014 Accenture All rights reserved.
14
Organizational effectiveness
• Strong and visible leadership with
deep workforce engagement
• Right technical, functional skills and
capabilities with effective knowledge
transfer and management
• Effective contingent labor
management
• Sharing of best practices
• Corporate culture committed to
continuous and deliberate
improvement of company
performance.
When leaders don’t lead,
Followers won’t follow
Copyright © 2014 Accenture All rights reserved.
15
Business performance management
• Insights and information
• Visibility of performance
• Manage by exception
• Increased accountability
• Closed loop
management system
High performing organization
Alignment
Near real–time data
collection (asset,
production)
Automatic filtering
and data quality
improvement
Merge of data from
multiple sources
Transform data
into insights
Visualize the Right info
to the Right people
Right time
Digitally enabled
Asset and
program
metrics
Corporate
metrics
Individual
score cards
Copyright © 2014 Accenture All rights reserved.
16
Key value drivers and typical results achieved
Operating
margin
Output
Pre-tax
ROIC
Business
benefits
Illustrative
Effectively addressing key value chain elements can deliver
significant benefits
Costs
Capital
employed
Risk
management
Key levers Range of typical impact
• Availability
• Reliability
• Throughput
• Product yield
• Operating expenses
• Catalysts/chemicals
• Energy costs
• Productivity
• Working capital
• On-time/on-budget projects
• CAPEX optimization
• Cash management
• Process/personal safety
• Standardization
• Environment protection
• Asset integrity As low as reasonable
practical
% Average throughput improvement
0% 8%
4%
% Average unit cost reduction
0% 15%
7%
% Average capital employed
reduction
0% 6%
3%
Level of operating risk
Copyright © 2014 Accenture All rights reserved.
17
Final remarks
“Perfection is not attainable,
but if we chase perfection
we can catch excellence.”
Vince Lombardi
(USA NFL Football Coach)
Copyright © 2014 Accenture All rights reserved.
