The document provides guidelines for procurement of goods, works and consulting services for projects financed by IFAD. It outlines the key responsibilities and principles of procurement which emphasize economy, efficiency, fairness and transparency. It describes the different methods of procurement for goods, works and consulting services and the processes that should be followed, including eligibility rules, advertising of bids, evaluation criteria, and contracting.
Clause 14.2 Advance Payment-Understanding Clauses in FIDIC ‘Conditions of Con...Divyanshu Dayal
•Advance payment is an interest free loan to the contractor.
•Advance payment is only paid on fulfillment of certain conditions as stipulated in the clause on receipt of a statement of an interim payment, advance guarantee and performance security.
•Advance guarantee shall remain valid until the advance payment has not been completely repaid. This repayment is done through proportional deduction in the contract price or as stipulated in the particular conditions of the contract.
•Advance payment is also linked with taking over certificate, termination of the contract and force majeure.
Clause 14.2 Advance Payment-Understanding Clauses in FIDIC ‘Conditions of Con...Divyanshu Dayal
•Advance payment is an interest free loan to the contractor.
•Advance payment is only paid on fulfillment of certain conditions as stipulated in the clause on receipt of a statement of an interim payment, advance guarantee and performance security.
•Advance guarantee shall remain valid until the advance payment has not been completely repaid. This repayment is done through proportional deduction in the contract price or as stipulated in the particular conditions of the contract.
•Advance payment is also linked with taking over certificate, termination of the contract and force majeure.
Construction Contracts Management based on UK common law using more than 40 cases of law with references from the UK, USA regulations, and international rules plus some examples from standard forms of construction contracts such as JCT, NEC & FIDIC.
This presentation shows how price adjustment may be applied to civil works contracts funded by the World Bank using experiences in Nigeria. It covers civil works contract without pre-qualification. It also highlights how price adjustment may be applied when the currency(ies) of payment is/are different from the currency of contract
Tips for effective administration of a construction contract and for reducing the risk of delay and change orders. Interplay between the contractors, the consultant and an owner.
Project Procurement Guidelines

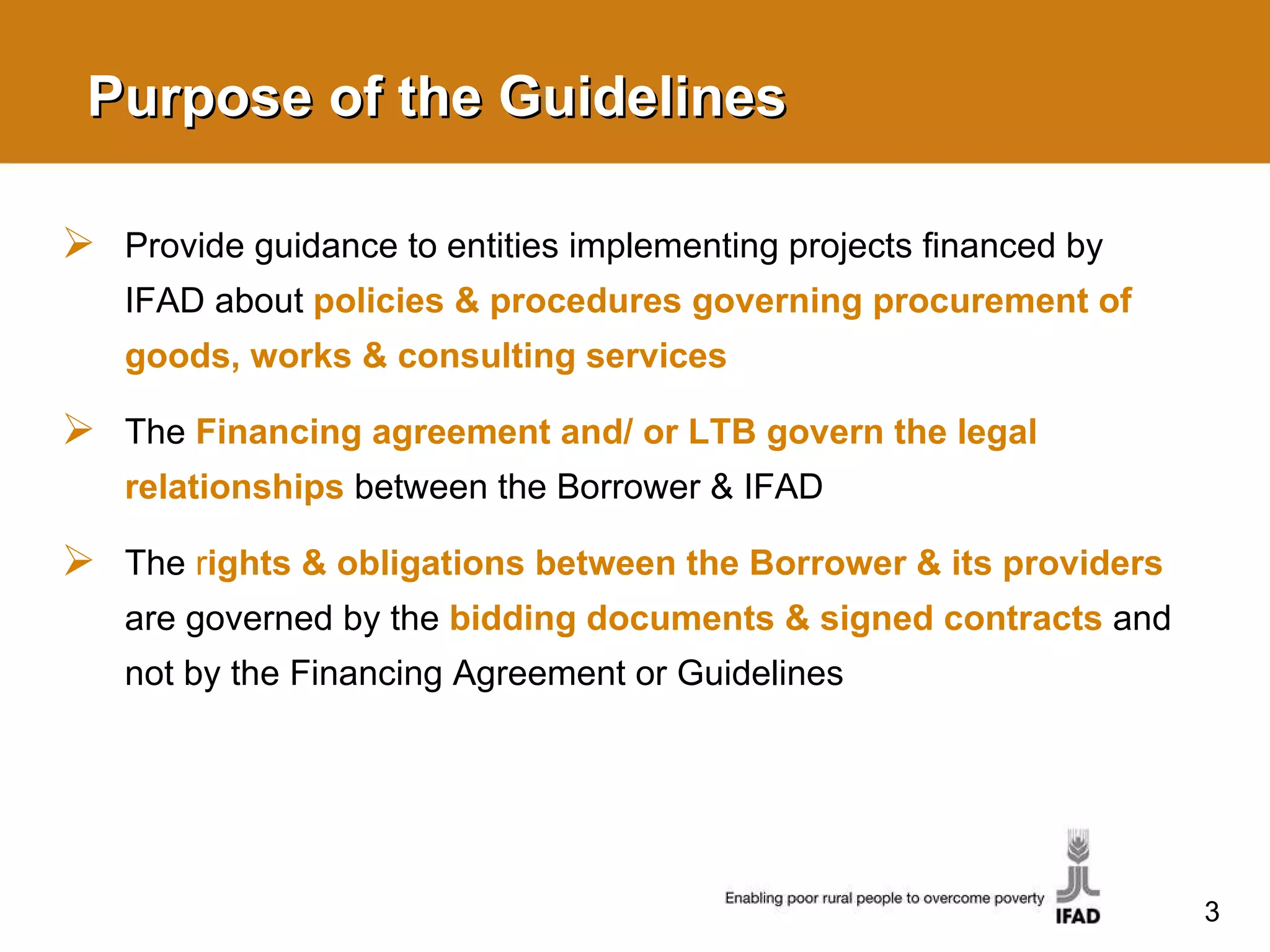

A. Background
1. Article 7, section 2(j) of the Agreement Establishing IFAD provides that the
Executive Board will adopt suitable regulations for procuring goods and services to
be financed from the resources of the Fund. These revised Procurement Guidelines
will apply to all projects and programmes financed from IFAD’s resources, and to
financing provided from supplementary funds unless otherwise agreed. They
replace the Procurement Guidelines adopted by the Executive Board in December 2004.
Procurement Guidelines
1. These Guidelines are intended to assist PI staff in handling procurement of Goods, Work and Consultancy Services in the context of IFAD Direct Supervision. It is a compendium of instructions, forms and checklists extracted from IFAD’s Guidelines for Supervision and Implementation Support.
It also draws from information distributed to IFAD staff during the Direct Supervision TrainingProgramme held at Casa San Bernardo during 2007/08.
Construction Contracts Management based on UK common law using more than 40 cases of law with references from the UK, USA regulations, and international rules plus some examples from standard forms of construction contracts such as JCT, NEC & FIDIC.
This presentation shows how price adjustment may be applied to civil works contracts funded by the World Bank using experiences in Nigeria. It covers civil works contract without pre-qualification. It also highlights how price adjustment may be applied when the currency(ies) of payment is/are different from the currency of contract
Tips for effective administration of a construction contract and for reducing the risk of delay and change orders. Interplay between the contractors, the consultant and an owner.
Project Procurement Guidelines
A. Background
1. Article 7, section 2(j) of the Agreement Establishing IFAD provides that the
Executive Board will adopt suitable regulations for procuring goods and services to
be financed from the resources of the Fund. These revised Procurement Guidelines
will apply to all projects and programmes financed from IFAD’s resources, and to
financing provided from supplementary funds unless otherwise agreed. They
replace the Procurement Guidelines adopted by the Executive Board in December 2004.
Procurement Guidelines
1. These Guidelines are intended to assist PI staff in handling procurement of Goods, Work and Consultancy Services in the context of IFAD Direct Supervision. It is a compendium of instructions, forms and checklists extracted from IFAD’s Guidelines for Supervision and Implementation Support.
It also draws from information distributed to IFAD staff during the Direct Supervision TrainingProgramme held at Casa San Bernardo during 2007/08.
How People Really Hold and Touch (their Phones)Steven Hoober
For the newest version of this presentation, always go to: 4ourth.com/tppt
For the latest video version, see: 4ourth.com/tvid
Presented at ConveyUX in Seattle, 7 Feb 2014
For the newest version of this presentation, always go to: 4ourth.com/tppt
For the latest video version, see: 4ourth.com/tvid
We are finally starting to think about how touchscreen devices really work, and design proper sized targets, think about touch as different from mouse selection, and to create common gesture libraries.
But despite this we still forget the user. Fingers and thumbs take up space, and cover the screen. Corners of screens have different accuracy than the center. It's time to re-evaluate what we think we know.
Steven reviews his ongoing research into how people actually interact with mobile devices, presents some new ideas on how we can design to avoid errors and take advantage of this new knowledge, and leaves you with 10 (relatively) simple steps to improve your touchscreen designs tomorrow.
CONTEMPORARY PROJECT MANAGEMENT, 4ETimothy J. KloppenborgVit.docxaidaclewer
CONTEMPORARY PROJECT MANAGEMENT, 4E
Timothy J. Kloppenborg
Vittal Anantatmula
Kathryn N. Wells
‹#›
Project Supply Chain Management
Chapter 13
‹#›
Chapter 13 Core Objectives:
Identify the role of supply chain management in project management and its importance for ensuring project success.
Describe how to plan, conduct, & control project procurements.
Chapter 13 Technical Objectives:
Describe the various formats for supply contracts and when each is appropriate.
Given a project situation, determine which activities, supplies, or services should be purchased; create bid documents; determine criteria you would use to select a seller; & determine which type of contract you would use.
Chapter 13 Behavioral Objectives:
Explain how to use the contemporary approach to project partnering and collaboration.
Super Absorbent Polymer Turf (SAPTURF)
“The SAPTURF project required a strong team. Successful commercialization of IP is a long shot, so room for project management error is slim. I realized I would need to compensate for lack of in-house resources. Lack of in-house resources is an advantage! I was free to look for the best resources…”
Chris Tetrault, owner and founder, SAPTURF
6
Introduction to Project Supply Chain Management
Inter-organizational purchasing-related issues supply chain management

A supply chain consists of all parties involved in fulfilling a customer request
Integrating SCM into PM can significantly enhance the effectiveness of project management
Introduction to Project Supply Chain Management
Integration of related functions to acquire needed products and services
Purchasing
Supply management
Procurement
Project Supply Chain Management
A system approach to managing flows of physical products, information, & funds from suppliers and producers, through resellers the project organization for creating customer satisfaction
SCM Components

Make-or-buy decision
Contract types
Collaboration and cooperation
System integration
Make-or-buy decisions – deciding whether to make something in-house or purchase it from a vendor
SCM Factors
The importance of SCM to general project management depends on a number of factors:
Value of outsourced products/services relative to value of the project
The timing of the work being purchased
Capability of the project team
Role of the outsourced work in the entire project
Number of suppliers required
Structure of the procurement supply chain
SCM Decisions
Distribution network configuration
Inventory control in supply chain
Logistics
Supply contracts
Distribution strategies
Supply chain integration & strategic partnering
Outsourcing & procurement strategies
Product design
Information technology & decision-support systems
Matching internal inadequacies with external experience
Project Procurement Management Processes
Plan Procurement Management
Conduct Procurements
Control Procurements
Plan Procurement Management
Plan for purchasing and acquisition
Complete most of pr.
Tender and Bidding in Construction ProjectsIJERA Editor
Construction Industry plays a key role in the process of economic transformation and growth. Export of projects and services indicate a country's progress in technology and export performance. Most of the companies are versed only with engineering and technology. The decision to bid is a major financial decision because of two reasons. First, the contractor assumes substantial costs for the preparations of the estimates and the tender at the risk of not recovering them if he is not awarded the job. Second, andmost importantly, thecontractor commits himself to investment in the construction of the project if he wins the bid.
11. A concrete dam can be assumed to be trapezoidal in section having a top width of 2 m and bottom width of 10 m. Its height is 12 m and the upstream face has a batter of 1: 10. Give an analysis of the stability of the dam for the base section for overturning and sliding in the full reservoir condition assuming no free-board allowance but allowing for uplift pressures. Assume uplift intensity factor ast 100%. Also determine the compressive stresses at the toe and the heel, and major principal and shear stress developed at the toe. Assume weight of concrete to be 24 kN/m³, unit shear strength of concrete
to be 1400 KN/m³, and the coefficient of friction between concrete and foundation soil to be 0.7.
12. The following data refer to the non-overflow section of a gravity dam:
R.L. of top of the dam
315 m.
R.L. of bottom of the dam
260 m
Full reservoir level
= 312 m
Top width of the dam
= 12 m.
Unstream face is vertical. Downstream face is vertical upto R.L. 304 m; and thereafter, the
Presentation discussing the requirements of the EU rules on public sector procurement and other things to be considered when purchasing in the public sector.
SLIC Introduction to procurement event, NLS, Edinburgh 09/11/2009.
Understanding Pre Qualification QuestionnairesLloyd Sewell
Tendering for contracts training offers a comprehensive training programme provided by small enterprise support specialists and public sector support specialists for small firms who wish to develop new revenue streams by tendering for public sector contracts.
Presentation of the “SIGMA workshop on tendering of PPP projects and contract signature”, held in Ankara on 11-12 April 2018. Presentation made by Mr. Mario Turkovic, SIGMA.

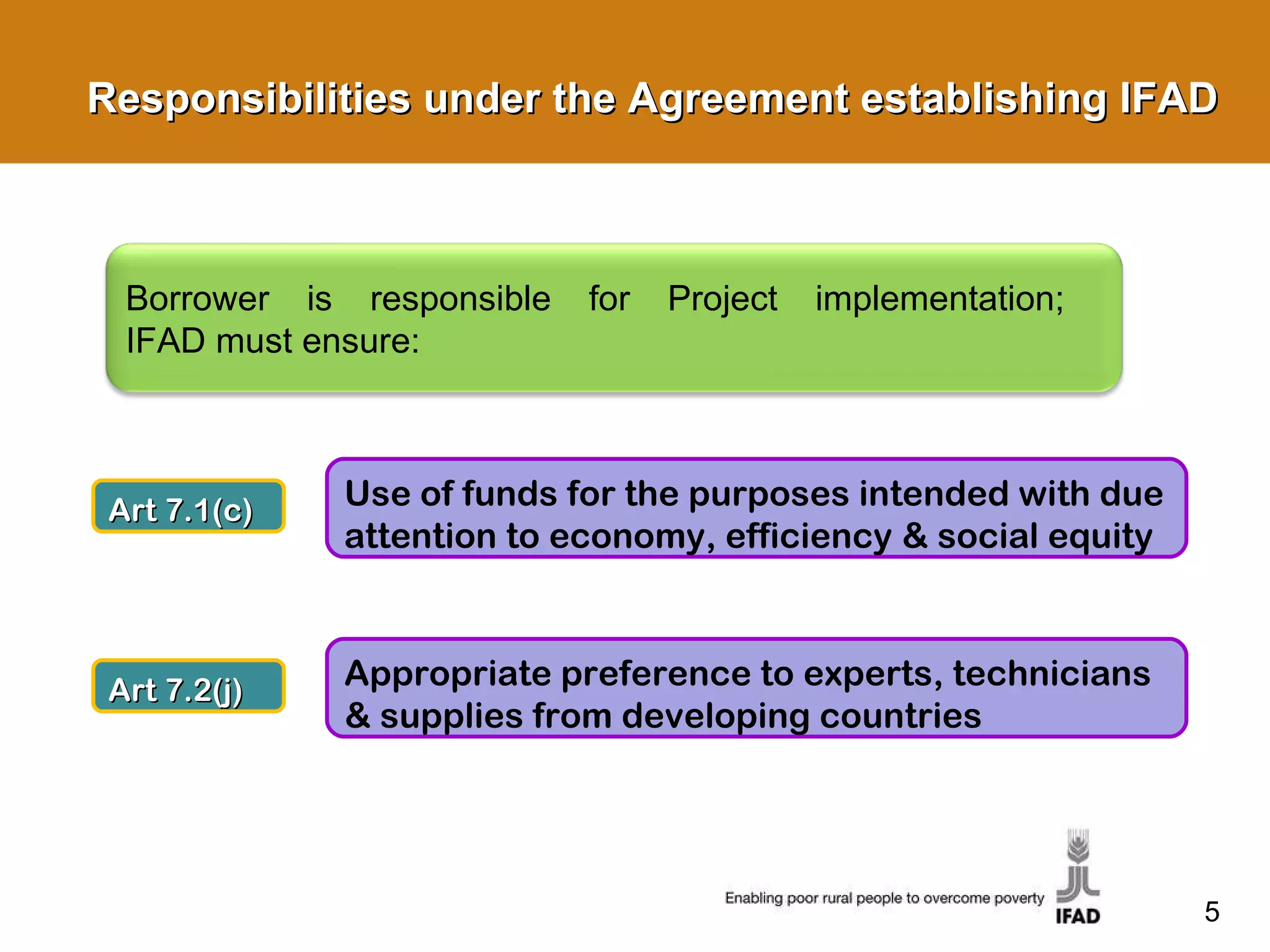

5. Responsibilities under the Agreement establishing IFAD Art 7.1(c) Use of funds for the purposes intended with due attention to economy, efficiency & social equity Art 7.2(j) Appropriate preference to experts, technicians & supplies from developing countries Borrower is responsible for Project implementation; IFAD must ensure:
6.
7.
8.

9. Eligibility Rules Change from September 2010: Goods, works & services provided by firms & individuals no longer have to be from IFAD member countries Pre – or post – qualification not to be denied for reasons other than capability and resources

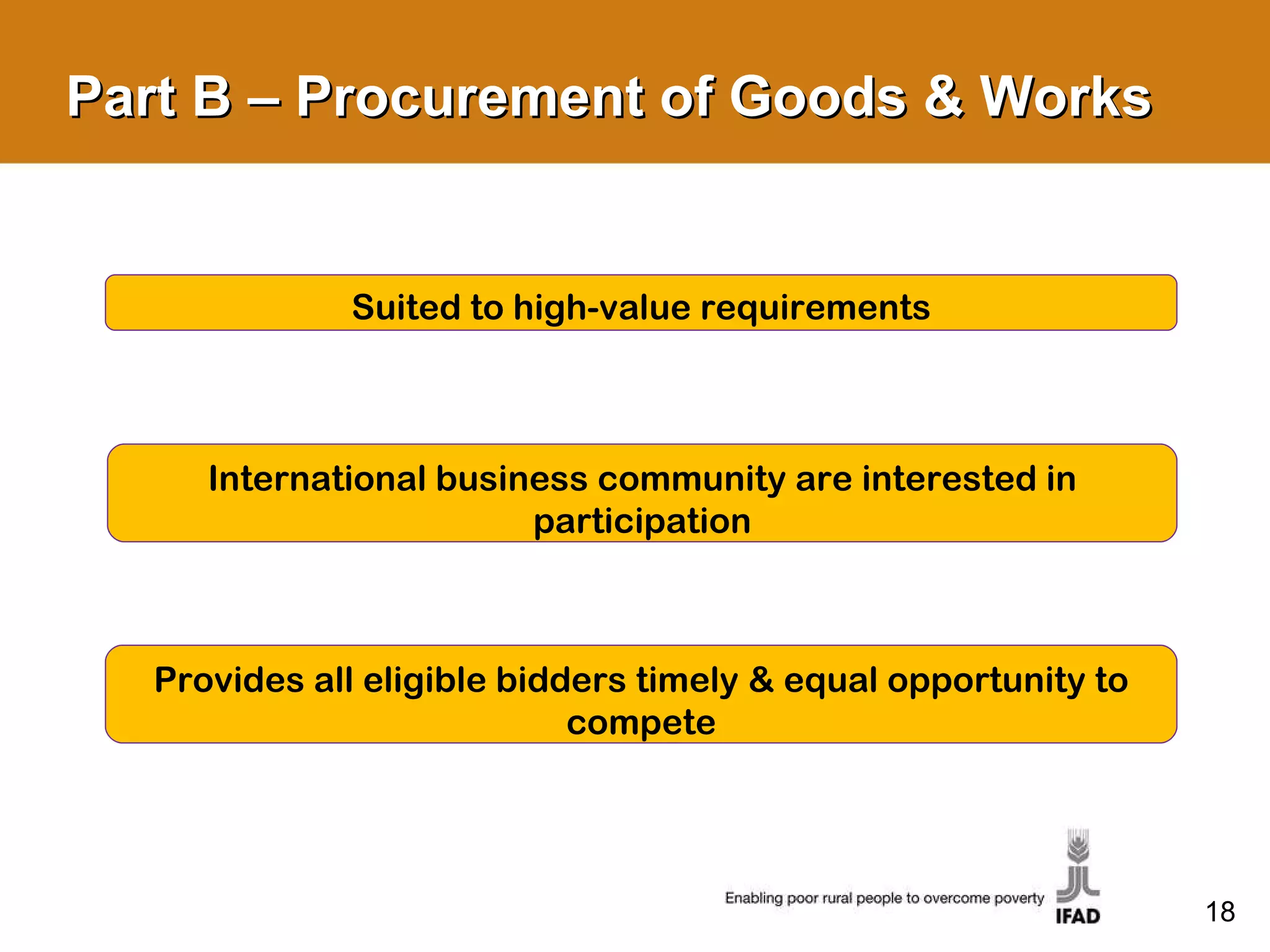

18. Part B – Procurement of Goods & Works Suited to high-value requirements International business community are interested in participation Provides all eligible bidders timely & equal opportunity to compete
19.
20.
21.
22.
23.
24.
25.
26.
27.
28.
29.
30.
31.
32.
33.
34.
35.
36.
37.
38.
39.
40.
41.
42.
43.
44.
45.
46.
47. Force Majeure Failure to perform is not considered a default If it is due to an unforeseeable event (force majeure)

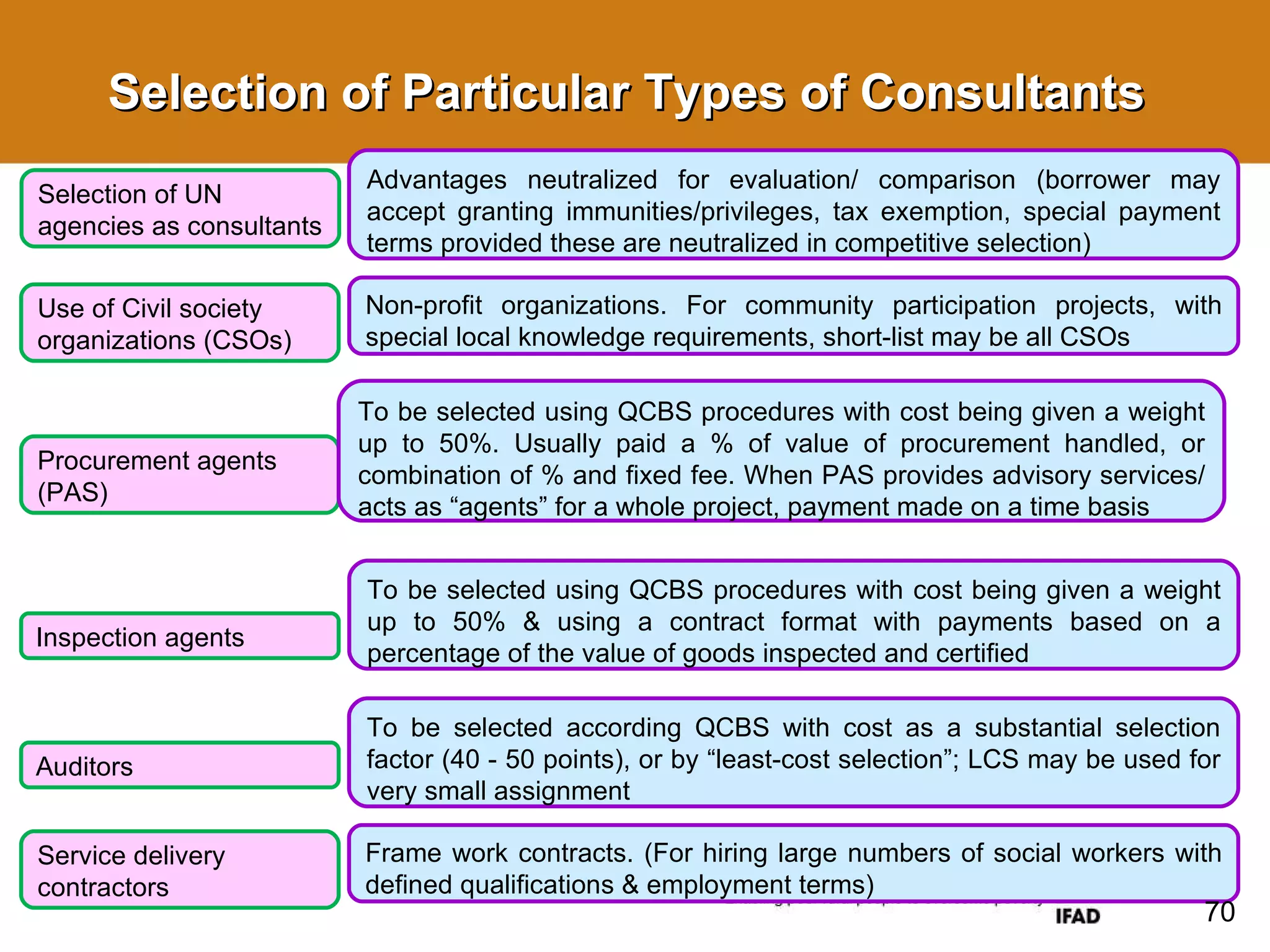

70. Selection of Particular Types of Consultants Selection of UN agencies as consultants Advantages neutralized for evaluation/ comparison (borrower may accept granting immunities/privileges, tax exemption, special payment terms provided these are neutralized in competitive selection) Use of Civil society organizations (CSOs) Non-profit organizations. For community participation projects, with special local knowledge requirements, short-list may be all CSOs Procurement agents (PAS) To be selected using QCBS procedures with cost being given a weight up to 50%. Usually paid a % of value of procurement handled, or combination of % and fixed fee. When PAS provides advisory services/ acts as “agents” for a whole project, payment made on a time basis Inspection agents To be selected using QCBS procedures with cost being given a weight up to 50% & using a contract format with payments based on a percentage of the value of goods inspected and certified Auditors To be selected according QCBS with cost as a substantial selection factor (40 - 50 points), or by “least-cost selection”; LCS may be used for very small assignment Service delivery contractors Frame work contracts. (For hiring large numbers of social workers with defined qualifications & employment terms)

83. Quantity and Value of Procurement Once the goods, works & related services to be procured are identified, estimation of quantity of goods & amount of works & services is critical for procurement planning & preparation When quantities to be procured are undetermined until project implementation (demand-driven), it may be permissible to allocate funds out of the loan as “undetermined procurement”
