WBS for Solara International eLearning CMS

                        Project Goal and Solution


                                    Migrate CMS       Test CMS




Create Course Modules           Software system      Hardware Infrastructure



       Create RIO                                     Network computers t

                               Install Courseware

       Create RLO                                        Install computers




                                                       Set up IT department
                                Install Software




    ACTIVITY                 TASK                   Christopher Thomas. IX.550
Solara International eLearning CMS

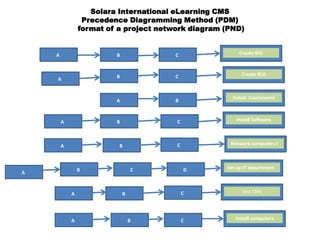

                 Precedence Diagramming Method (PDM)
                format of a project network diagram (PND)


    A                    B              C                Create RIO



                         B              C                 Create RLO
    A


                                                      Install Courseware
                         A              B



        A                B              C              Install Software



        A                 B             C            Network computers t



                B                C          D       Set up IT department
A


            A                B              C             Test CMS




            A                    B          C          Install computers

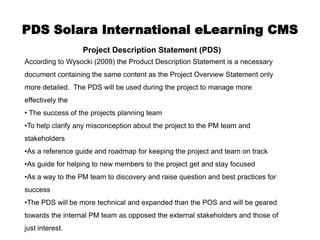

PDS Solara International eLearning CMS
                  Project Description Statement (PDS)
According to Wysocki (2009) the Product Description Statement is a necessary
document containing the same content as the Project Overview Statement only
more detailed. The PDS will be used during the project to manage more
effectively the
• The success of the projects planning team
•To help clarify any misconception about the project to the PM team and
stakeholders
•As a reference guide and roadmap for keeping the project and team on track
•As guide for helping to new members to the project get and stay focused
•As a way to the PM team to discovery and raise question and best practices for
success
•The PDS will be more technical and expanded than the POS and will be geared
towards the internal PM team as opposed the external stakeholders and those of
just interest.

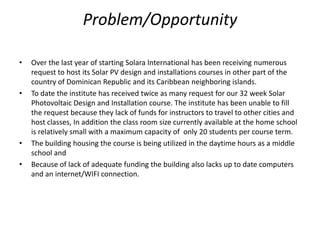

Problem/Opportunity

•   Over the last year of starting Solara International has been receiving numerous
    request to host its Solar PV design and installations courses in other part of the
    country of Dominican Republic and its Caribbean neighboring islands.
•   To date the institute has received twice as many request for our 32 week Solar
    Photovoltaic Design and Installation course. The institute has been unable to fill
    the request because they lack of funds for instructors to travel to other cities and
    host classes, In addition the class room size currently available at the home school
    is relatively small with a maximum capacity of only 20 students per course term.
•   The building housing the course is being utilized in the daytime hours as a middle
    school and
•   Because of lack of adequate funding the building also lacks up to date computers
    and an internet/WIFI connection.
Project goal
•   The Goals of Solara International institute are two-fold

•   First the institute would like to service the increasing demand for 21st Job skills that increase
    the potentials for the learners to obtain good paying job while addressing the growth of
    renewable energy solutions.
    Solara International is committed to the understanding and promotion of renewable energy
    solutions in the Caribbean's.
•   Knowledge - Prepare a highly skilled workforce which will drive economic development
    and prosperity in the Caribbean islands.
•   Sustainability- Ensure that existing renewable energy assets are functioning and productive
    that future installations are completed according to the highest possible standards.
•   Empowerment- Provide the opportunity for young adults to develop their business acumen
    and to cultivate relationship leading to employment and entrepreneur activities.
•    Our Second Goal is
•   Identification of renewable energy opportunities.
•   Training and design of Renewable energy gardens and farms.
•   Installation of residential renewable energy plants.
•   Provide well customized training courses for renewable energy technicians ,designers and
    entrepreneurs.
•   Business Management.
•   Partner with Established institutions and authorities on training ,energy transmission and
    distribution.
•   Partner with government to meet local and international standards for electrical installations.
•   To invest in the manufacture of equipment & machines required in the renewable industries.

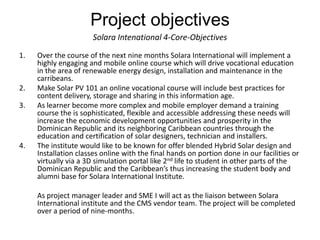

Project objectives
                       Solara Intenational 4-Core-Objectives
1.   Over the course of the next nine months Solara International will implement a
     highly engaging and mobile online course which will drive vocational education
     in the area of renewable energy design, installation and maintenance in the
     carribeans.
2.   Make Solar PV 101 an online vocational course will include best practices for
     content delivery, storage and sharing in this information age.
3.   As learner become more complex and mobile employer demand a training
     course the is sophisticated, flexible and accessible addressing these needs will
     increase the economic development opportunities and prosperity in the
     Dominican Republic and its neighboring Caribbean countries through the
     education and certification of solar designers, technician and installers.
4.   The institute would like to be known for offer blended Hybrid Solar design and
     Installation classes online with the final hands on portion done in our facilities or
     virtually via a 3D simulation portal like 2nd life to student in other parts of the
     Dominican Republic and the Caribbean’s thus increasing the student body and
     alumni base for Solara International Institute.

     As project manager leader and SME I will act as the liaison between Solara
     International institute and the CMS vendor team. The project will be completed
     over a period of nine-months.

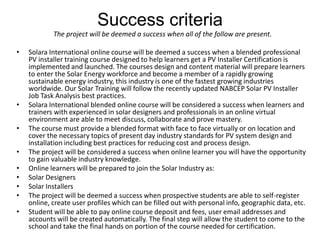

Success criteria
            The project will be deemed a success when all of the follow are present.

•   Solara International online course will be deemed a success when a blended professional
    PV installer training course designed to help learners get a PV Installer Certification is
    implemented and launched. The courses design and content material will prepare learners
    to enter the Solar Energy workforce and become a member of a rapidly growing
    sustainable energy industry, this industry is one of the fastest growing industries
    worldwide. Our Solar Training will follow the recently updated NABCEP Solar PV Installer
    Job Task Analysis best practices.
•   Solara International blended online course will be considered a success when learners and
    trainers with experienced in solar designers and professionals in an online virtual
    environment are able to meet discuss, collaborate and prove mastery.
•   The course must provide a blended format with face to face virtually or on location and
    cover the necessary topics of present day industry standards for PV system design and
    installation including best practices for reducing cost and process design.
•   The project will be considered a success when online learner you will have the opportunity
    to gain valuable industry knowledge.
•   Online learners will be prepared to join the Solar Industry as:
•   Solar Designers
•   Solar Installers
•   The project will be deemed a success when prospective students are able to self-register
    online, create user profiles which can be filled out with personal info, geographic data, etc.
•   Student will be able to pay online course deposit and fees, user email addresses and
    accounts will be created automatically. The final step will allow the student to come to the
    school and take the final hands on portion of the course needed for certification.

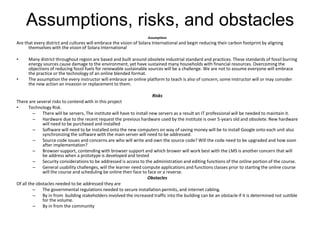

Assumptions, risks, and obstacles
                                                                   Assumptions
Are that every district and cultures will embrace the vision of Solara International and begin reducing their carbon footprint by aligning
      themselves with the vision of Solara International

•     Many district throughout region are based and built around obsolete industrial standard and practices. These standards of fossil burring
      energy sources cause damage to the environment, yet have sustained many households with financial resources. Overcoming the
      objections of reducing fossil fuels for renewable sustainable sources will be a challenge. We are not to assume everyone will embrace
      the practice or the technology of an online blended format.
•     The assumption the every instructor will embrace an online platform to teach is also of concern, some instructor will or may consider
      the new action an invasion or replacement to them.

                                                                      Risks
There are several risks to contend with in this project
•      Technology Risk.
         – There will be servers, The institute will have to install new servers as a result an IT professional will be needed to maintain it.
         – Hardware due to the recent request the previous hardware used by the institute is over 5-years old and obsolete. New hardware
              will need to be purchased and installed
         – Software will need to be installed onto the new computers on way of saving money will be to install Google onto each unit also
              synchronizing the software with the main server will need to be addressed.
         – Source code issues and concerns are who will write and own the source code? Will the code need to be upgraded and how soon
              after implementation?
         – Browser support, contending with browser support and which brower will work best with the LMS is another concern that will
              be address when a prototype is developed and tested
         – Security considerations to be addressed is access to the administration and editing functions of the online portion of the course.
         – General usability challenges, will the learner need compute applications and functions classes prior to starting the online course
              will the course and scheduling be online then face to face or a reverse.
                                                                    Obstacles
Of all the obstacles needed to be addressed they are
         – The governmental regulations needed to secure installation permits, and internet cabling.
         – By in from building stakeholders involved the increased traffic into the building can be an obstacle if it is determined not suitible
              for the volume.
         – By in from the community

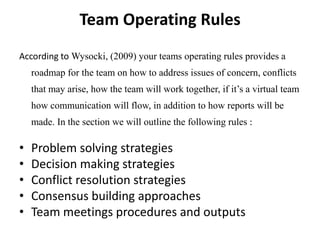

Team Operating Rules
According to Wysocki, (2009) your teams operating rules provides a
    roadmap for the team on how to address issues of concern, conflicts
    that may arise, how the team will work together, if it’s a virtual team
    how communication will flow, in addition to how reports will be
    made. In the section we will outline the following rules :

•   Problem solving strategies
•   Decision making strategies
•   Conflict resolution strategies
•   Consensus building approaches
•   Team meetings procedures and outputs

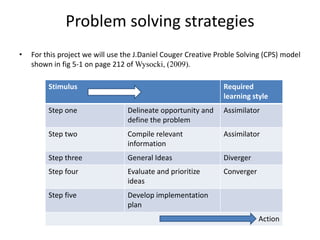

Problem solving strategies
•   For this project we will use the J.Daniel Couger Creative Proble Solving (CPS) model
    shown in fig 5-1 on page 212 of Wysocki, (2009).

         Stimulus                                               Required
                                                                learning style
         Step one                 Delineate opportunity and     Assimilator
                                  define the problem
         Step two                 Compile relevant              Assimilator
                                  information
         Step three               General Ideas                 Diverger
         Step four                Evaluate and prioritize       Converger
                                  ideas
         Step five                Develop implementation
                                  plan
                                                                            Action

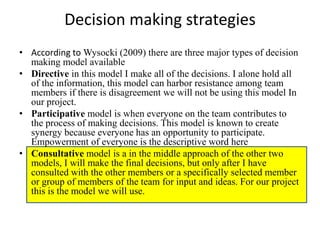

Decision making strategies
• According to Wysocki (2009) there are three major types of decision
  making model available
• Directive in this model I make all of the decisions. I alone hold all
  of the information, this model can harbor resistance among team
  members if there is disagreement we will not be using this model In
  our project.
• Participative model is when everyone on the team contributes to
  the process of making decisions. This model is known to create
  synergy because everyone has an opportunity to participate.
  Empowerment of everyone is the descriptive word here
• Consultative model is a in the middle approach of the other two
  models, I will make the final decisions, but only after I have
  consulted with the other members or a specifically selected member
  or group of members of the team for input and ideas. For our project
  this is the model we will use.

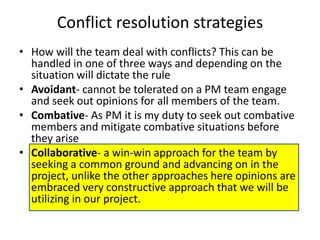

Conflict resolution strategies
• How will the team deal with conflicts? This can be
  handled in one of three ways and depending on the
  situation will dictate the rule
• Avoidant- cannot be tolerated on a PM team engage
  and seek out opinions for all members of the team.
• Combative- As PM it is my duty to seek out combative
  members and mitigate combative situations before
  they arise
• Collaborative- a win-win approach for the team by
  seeking a common ground and advancing on in the
  project, unlike the other approaches here opinions are
  embraced very constructive approach that we will be
  utilizing in our project.

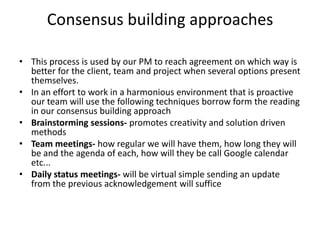

Consensus building approaches

• This process is used by our PM to reach agreement on which way is
  better for the client, team and project when several options present
  themselves.
• In an effort to work in a harmonious environment that is proactive
  our team will use the following techniques borrow form the reading
  in our consensus building approach
• Brainstorming sessions- promotes creativity and solution driven
  methods
• Team meetings- how regular we will have them, how long they will
  be and the agenda of each, how will they be call Google calendar
  etc...
• Daily status meetings- will be virtual simple sending an update
  from the previous acknowledgement will suffice
Team meetings procedures and outputs

 • Choosing an effective communication channel
   for our project we will be using the following
   communication channels
 • Face to Face
 • E-mail and Google calendar
 • Cell phones and voice messaging
 • Instant messaging services
References
•   Wysocki, R. K. (2009). Effective project management: Traditional, agile, extreme.
    Wiley publishing Inc. Indianapolis, Indiana

Wbs solara international e learning cms

  • 1.
    WBS for SolaraInternational eLearning CMS Project Goal and Solution Migrate CMS Test CMS Create Course Modules Software system Hardware Infrastructure Create RIO Network computers t Install Courseware Create RLO Install computers Set up IT department Install Software ACTIVITY TASK Christopher Thomas. IX.550
  • 2.
    Solara International eLearningCMS Precedence Diagramming Method (PDM) format of a project network diagram (PND) A B C Create RIO B C Create RLO A Install Courseware A B A B C Install Software A B C Network computers t B C D Set up IT department A A B C Test CMS A B C Install computers
  • 3.
    PDS Solara InternationaleLearning CMS Project Description Statement (PDS) According to Wysocki (2009) the Product Description Statement is a necessary document containing the same content as the Project Overview Statement only more detailed. The PDS will be used during the project to manage more effectively the • The success of the projects planning team •To help clarify any misconception about the project to the PM team and stakeholders •As a reference guide and roadmap for keeping the project and team on track •As guide for helping to new members to the project get and stay focused •As a way to the PM team to discovery and raise question and best practices for success •The PDS will be more technical and expanded than the POS and will be geared towards the internal PM team as opposed the external stakeholders and those of just interest.
  • 4.
    Problem/Opportunity • Over the last year of starting Solara International has been receiving numerous request to host its Solar PV design and installations courses in other part of the country of Dominican Republic and its Caribbean neighboring islands. • To date the institute has received twice as many request for our 32 week Solar Photovoltaic Design and Installation course. The institute has been unable to fill the request because they lack of funds for instructors to travel to other cities and host classes, In addition the class room size currently available at the home school is relatively small with a maximum capacity of only 20 students per course term. • The building housing the course is being utilized in the daytime hours as a middle school and • Because of lack of adequate funding the building also lacks up to date computers and an internet/WIFI connection.
  • 5.
    Project goal • The Goals of Solara International institute are two-fold • First the institute would like to service the increasing demand for 21st Job skills that increase the potentials for the learners to obtain good paying job while addressing the growth of renewable energy solutions. Solara International is committed to the understanding and promotion of renewable energy solutions in the Caribbean's. • Knowledge - Prepare a highly skilled workforce which will drive economic development and prosperity in the Caribbean islands. • Sustainability- Ensure that existing renewable energy assets are functioning and productive that future installations are completed according to the highest possible standards. • Empowerment- Provide the opportunity for young adults to develop their business acumen and to cultivate relationship leading to employment and entrepreneur activities. • Our Second Goal is • Identification of renewable energy opportunities. • Training and design of Renewable energy gardens and farms. • Installation of residential renewable energy plants. • Provide well customized training courses for renewable energy technicians ,designers and entrepreneurs. • Business Management. • Partner with Established institutions and authorities on training ,energy transmission and distribution. • Partner with government to meet local and international standards for electrical installations. • To invest in the manufacture of equipment & machines required in the renewable industries.
  • 6.
    Project objectives Solara Intenational 4-Core-Objectives 1. Over the course of the next nine months Solara International will implement a highly engaging and mobile online course which will drive vocational education in the area of renewable energy design, installation and maintenance in the carribeans. 2. Make Solar PV 101 an online vocational course will include best practices for content delivery, storage and sharing in this information age. 3. As learner become more complex and mobile employer demand a training course the is sophisticated, flexible and accessible addressing these needs will increase the economic development opportunities and prosperity in the Dominican Republic and its neighboring Caribbean countries through the education and certification of solar designers, technician and installers. 4. The institute would like to be known for offer blended Hybrid Solar design and Installation classes online with the final hands on portion done in our facilities or virtually via a 3D simulation portal like 2nd life to student in other parts of the Dominican Republic and the Caribbean’s thus increasing the student body and alumni base for Solara International Institute. As project manager leader and SME I will act as the liaison between Solara International institute and the CMS vendor team. The project will be completed over a period of nine-months.
  • 7.
    Success criteria The project will be deemed a success when all of the follow are present. • Solara International online course will be deemed a success when a blended professional PV installer training course designed to help learners get a PV Installer Certification is implemented and launched. The courses design and content material will prepare learners to enter the Solar Energy workforce and become a member of a rapidly growing sustainable energy industry, this industry is one of the fastest growing industries worldwide. Our Solar Training will follow the recently updated NABCEP Solar PV Installer Job Task Analysis best practices. • Solara International blended online course will be considered a success when learners and trainers with experienced in solar designers and professionals in an online virtual environment are able to meet discuss, collaborate and prove mastery. • The course must provide a blended format with face to face virtually or on location and cover the necessary topics of present day industry standards for PV system design and installation including best practices for reducing cost and process design. • The project will be considered a success when online learner you will have the opportunity to gain valuable industry knowledge. • Online learners will be prepared to join the Solar Industry as: • Solar Designers • Solar Installers • The project will be deemed a success when prospective students are able to self-register online, create user profiles which can be filled out with personal info, geographic data, etc. • Student will be able to pay online course deposit and fees, user email addresses and accounts will be created automatically. The final step will allow the student to come to the school and take the final hands on portion of the course needed for certification.
  • 8.
    Assumptions, risks, andobstacles Assumptions Are that every district and cultures will embrace the vision of Solara International and begin reducing their carbon footprint by aligning themselves with the vision of Solara International • Many district throughout region are based and built around obsolete industrial standard and practices. These standards of fossil burring energy sources cause damage to the environment, yet have sustained many households with financial resources. Overcoming the objections of reducing fossil fuels for renewable sustainable sources will be a challenge. We are not to assume everyone will embrace the practice or the technology of an online blended format. • The assumption the every instructor will embrace an online platform to teach is also of concern, some instructor will or may consider the new action an invasion or replacement to them. Risks There are several risks to contend with in this project • Technology Risk. – There will be servers, The institute will have to install new servers as a result an IT professional will be needed to maintain it. – Hardware due to the recent request the previous hardware used by the institute is over 5-years old and obsolete. New hardware will need to be purchased and installed – Software will need to be installed onto the new computers on way of saving money will be to install Google onto each unit also synchronizing the software with the main server will need to be addressed. – Source code issues and concerns are who will write and own the source code? Will the code need to be upgraded and how soon after implementation? – Browser support, contending with browser support and which brower will work best with the LMS is another concern that will be address when a prototype is developed and tested – Security considerations to be addressed is access to the administration and editing functions of the online portion of the course. – General usability challenges, will the learner need compute applications and functions classes prior to starting the online course will the course and scheduling be online then face to face or a reverse. Obstacles Of all the obstacles needed to be addressed they are – The governmental regulations needed to secure installation permits, and internet cabling. – By in from building stakeholders involved the increased traffic into the building can be an obstacle if it is determined not suitible for the volume. – By in from the community
  • 9.
    Team Operating Rules Accordingto Wysocki, (2009) your teams operating rules provides a roadmap for the team on how to address issues of concern, conflicts that may arise, how the team will work together, if it’s a virtual team how communication will flow, in addition to how reports will be made. In the section we will outline the following rules : • Problem solving strategies • Decision making strategies • Conflict resolution strategies • Consensus building approaches • Team meetings procedures and outputs
  • 10.
    Problem solving strategies • For this project we will use the J.Daniel Couger Creative Proble Solving (CPS) model shown in fig 5-1 on page 212 of Wysocki, (2009). Stimulus Required learning style Step one Delineate opportunity and Assimilator define the problem Step two Compile relevant Assimilator information Step three General Ideas Diverger Step four Evaluate and prioritize Converger ideas Step five Develop implementation plan Action
  • 11.
    Decision making strategies •According to Wysocki (2009) there are three major types of decision making model available • Directive in this model I make all of the decisions. I alone hold all of the information, this model can harbor resistance among team members if there is disagreement we will not be using this model In our project. • Participative model is when everyone on the team contributes to the process of making decisions. This model is known to create synergy because everyone has an opportunity to participate. Empowerment of everyone is the descriptive word here • Consultative model is a in the middle approach of the other two models, I will make the final decisions, but only after I have consulted with the other members or a specifically selected member or group of members of the team for input and ideas. For our project this is the model we will use.
  • 12.
    Conflict resolution strategies •How will the team deal with conflicts? This can be handled in one of three ways and depending on the situation will dictate the rule • Avoidant- cannot be tolerated on a PM team engage and seek out opinions for all members of the team. • Combative- As PM it is my duty to seek out combative members and mitigate combative situations before they arise • Collaborative- a win-win approach for the team by seeking a common ground and advancing on in the project, unlike the other approaches here opinions are embraced very constructive approach that we will be utilizing in our project.
  • 13.
    Consensus building approaches •This process is used by our PM to reach agreement on which way is better for the client, team and project when several options present themselves. • In an effort to work in a harmonious environment that is proactive our team will use the following techniques borrow form the reading in our consensus building approach • Brainstorming sessions- promotes creativity and solution driven methods • Team meetings- how regular we will have them, how long they will be and the agenda of each, how will they be call Google calendar etc... • Daily status meetings- will be virtual simple sending an update from the previous acknowledgement will suffice
  • 14.
    Team meetings proceduresand outputs • Choosing an effective communication channel for our project we will be using the following communication channels • Face to Face • E-mail and Google calendar • Cell phones and voice messaging • Instant messaging services
  • 15.
    References • Wysocki, R. K. (2009). Effective project management: Traditional, agile, extreme. Wiley publishing Inc. Indianapolis, Indiana
