Infrastructure and Projects Authority
UK-Caribbean Infrastructure Conference
23 November 2023
St Vincent & the Grenadines
UK Experience in Infrastructure
Development:
from planning and prioritisation
through to delivery and monitoring.
Javier Encinas
Deputy Head of International
Project and Structured Finance Group
Infrastructure and Projects Authority
HM Treasury and Cabinet Office
UK-Caribbean
Infrastructure Conference
Infrastructure and Projects Authority
UK current and past infrastructure status
3 |
Infrastructureand Projects Authority
Sustainable Infrastructure Course
Infrastructure and Projects Authority

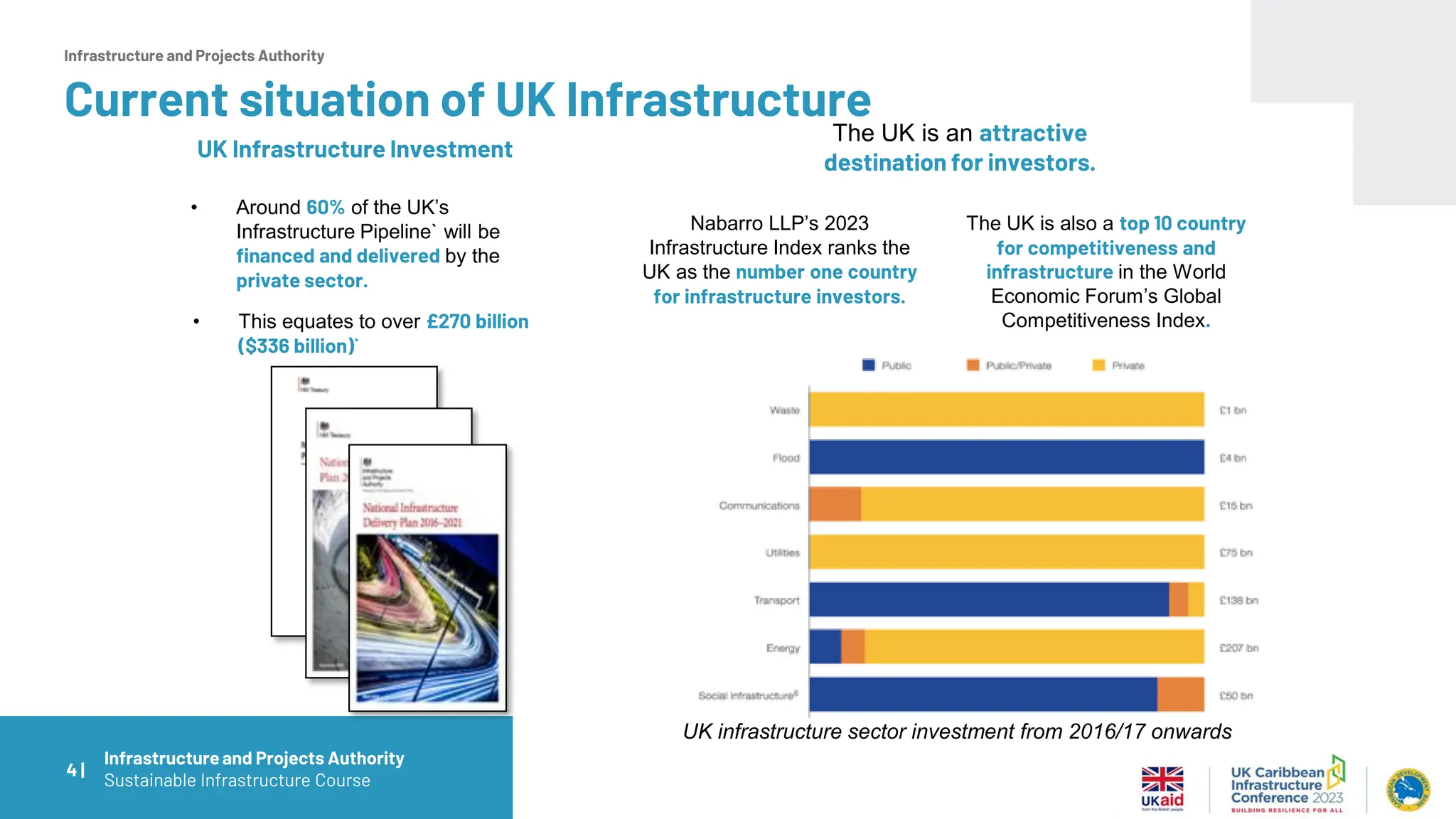

UK Infrastructure Investment
• Around 60% of the UK’s
Infrastructure Pipeline` will be
financed and delivered by the
private sector.
UK infrastructure sector investment from 2016/17 onwards
• This equates to over £270 billion
($336 billion)`
The UK is an attractive
destination for investors.
Nabarro LLP’s 2023
Infrastructure Index ranks the
UK as the number one country
for infrastructure investors.
The UK is also a top 10 country
for competitiveness and
infrastructure in the World
Economic Forum’s Global
Competitiveness Index.
4 |
Infrastructureand Projects Authority
Sustainable Infrastructure Course
Current situation of UK Infrastructure
Infrastructure and Projects Authority

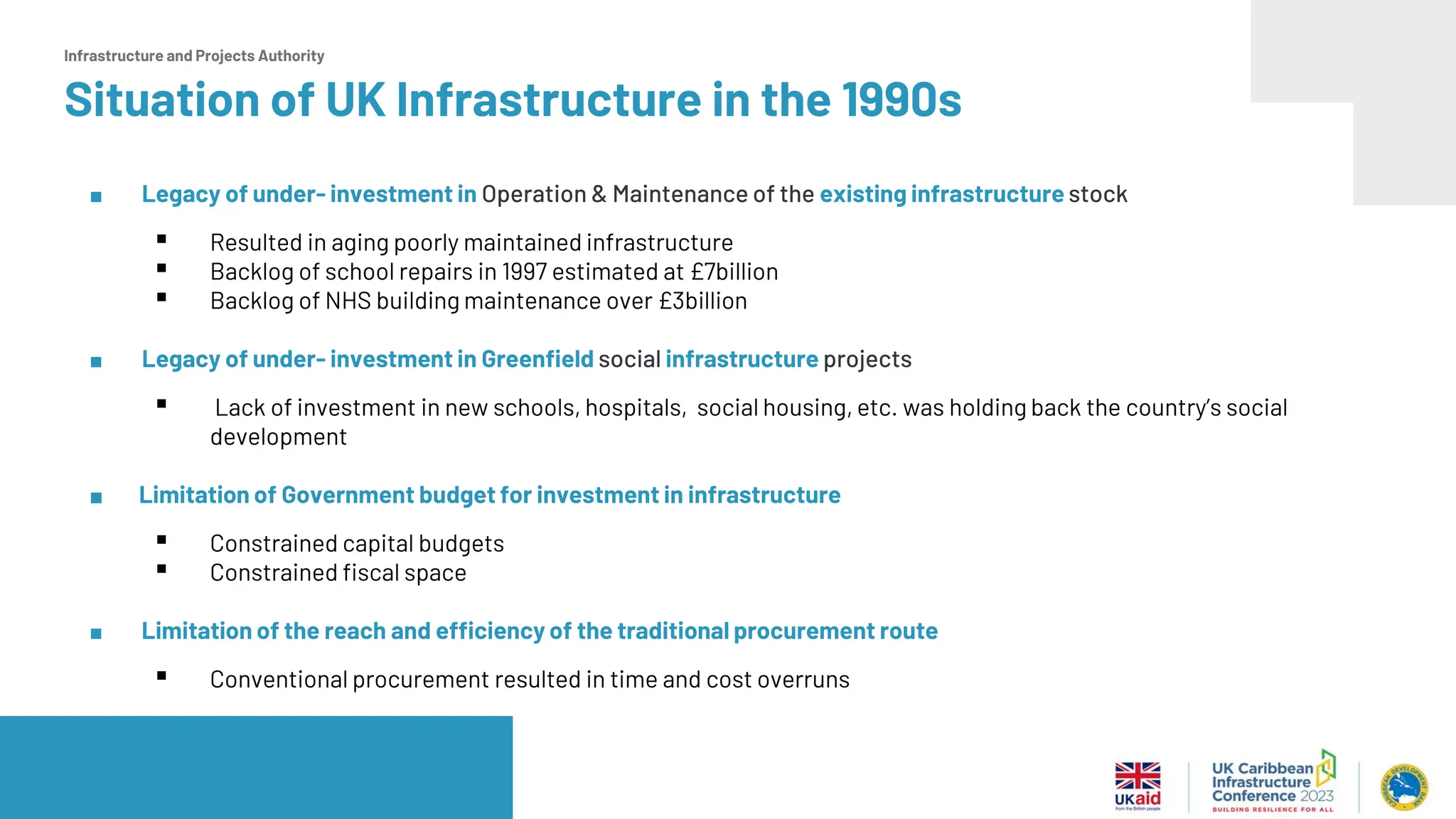

Situation of UK Infrastructure in the 1990s
■ Legacy of under- investment in Operation & Maintenance of the existing infrastructure stock
▪ Resulted in aging poorly maintained infrastructure
▪ Backlog of school repairs in 1997 estimated at £7billion
▪ Backlog of NHS building maintenance over £3billion
■ Legacy of under- investment in Greenfield social infrastructure projects
▪ Lack of investment in new schools, hospitals, social housing, etc. was holding back the country’s social
development
■ Limitation of Government budget for investment in infrastructure
▪ Constrained capital budgets
▪ Constrained fiscal space
■ Limitation of the reach and efficiency of the traditional procurement route
▪ Conventional procurement resulted in time and cost overruns
Infrastructure and Projects Authority

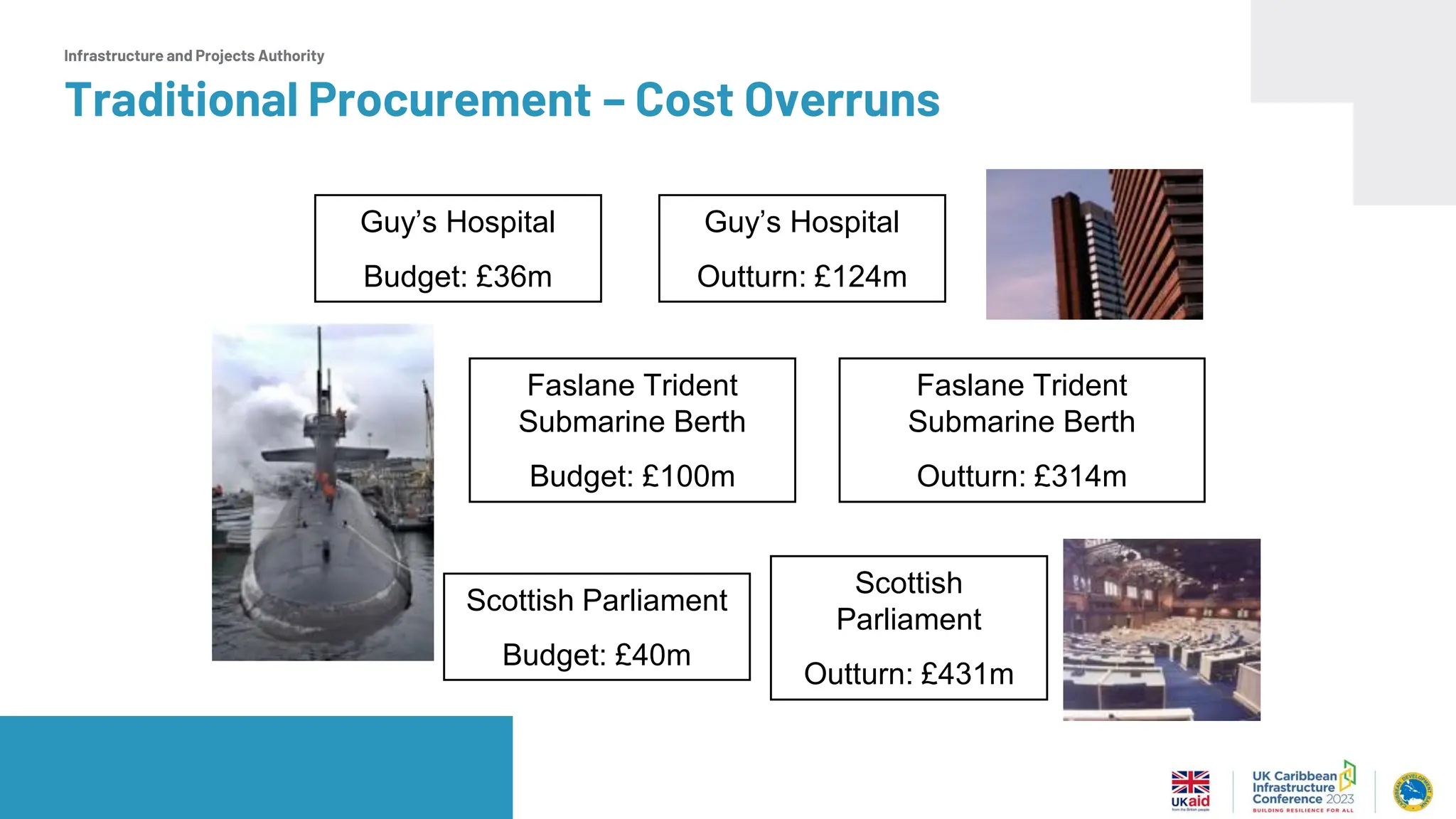

Traditional Procurement – Cost Overruns
Guy’s Hospital
Budget: £36m
Guy’s Hospital
Outturn: £124m
Faslane Trident
Submarine Berth
Budget: £100m
Faslane Trident
Submarine Berth
Outturn: £314m
Scottish Parliament
Budget: £40m
Scottish
Parliament
Outturn: £431m
Infrastructure and Projects Authority

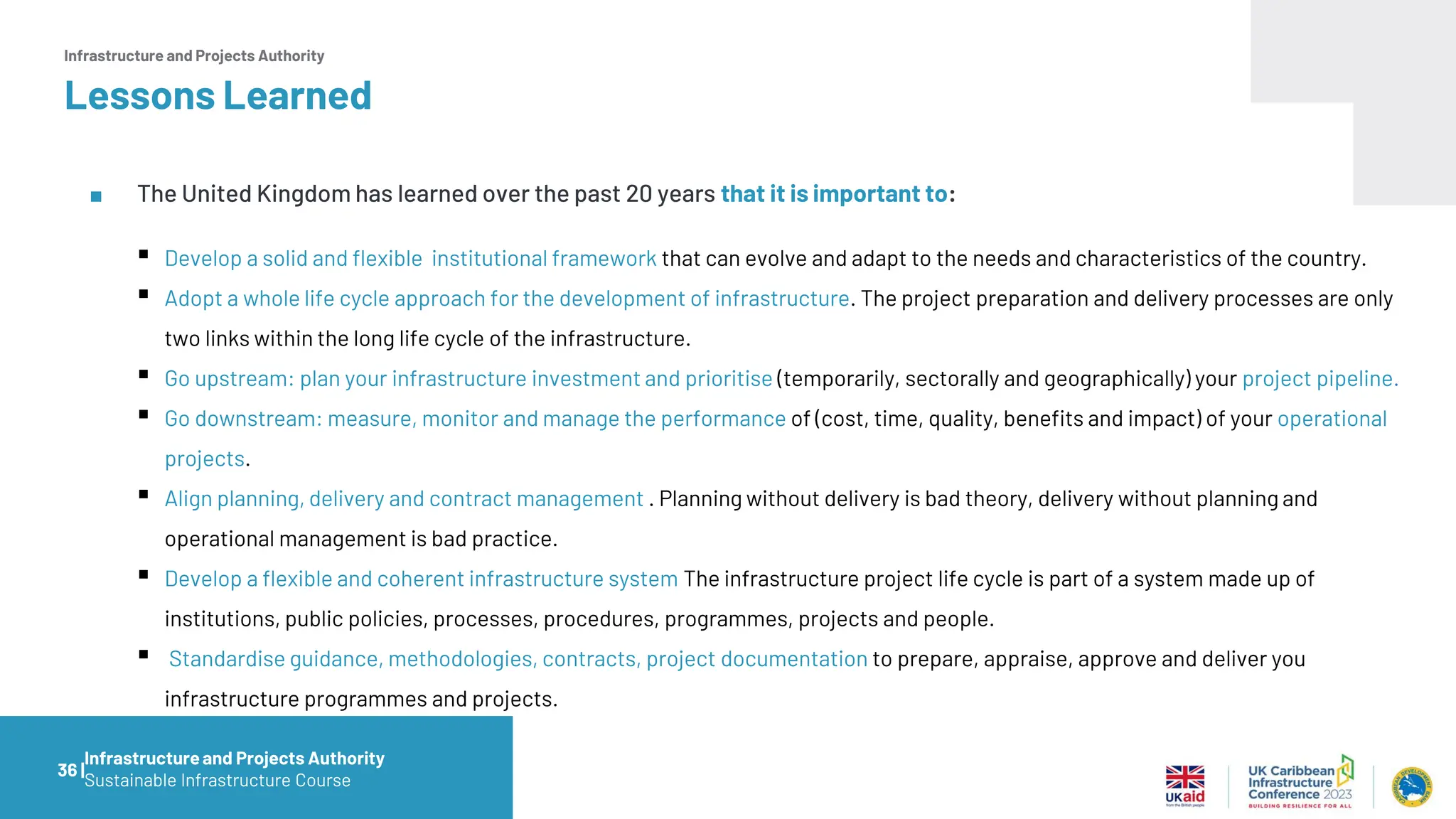

Lessons learned in the UK and key recommendations
7 |
Infrastructureand Projects Authority
Sustainable Infrastructure Course
Infrastructure and Projects Authority
Recommendation 1:
Develop a solid and flexible institutional framework
8 |
Infrastructureand Projects Authority
Sustainable Infrastructure Course
Infrastructure and Projects Authority
BEIS, Department for Business, Energy and Industrial Strategy; CO, Cabinet Office; DCLG, Department for Communities and Local Government; DCMS, Department for
Digital, Culture, Media and Sport; Defra, Department for Environment, Food and Rural Affairs; DfT, Department for Transport; DIT, Department for International Trade; ERDF,
European Regional Development Fund; HMT, the Treasury; HS2, High Speed Two; IPA, Infrastructure and Projects Authority; LEP, Local Enterprise Partnership; NIC,
National Infrastructure Commission; ORR, Office of Rail and Road; PFO, private finance initiative; PPP, public private partnership; SoS, Secretary of State. Ministerial names
correct as of November 2017.
Source: Adapted from map of Institute for Government analysis

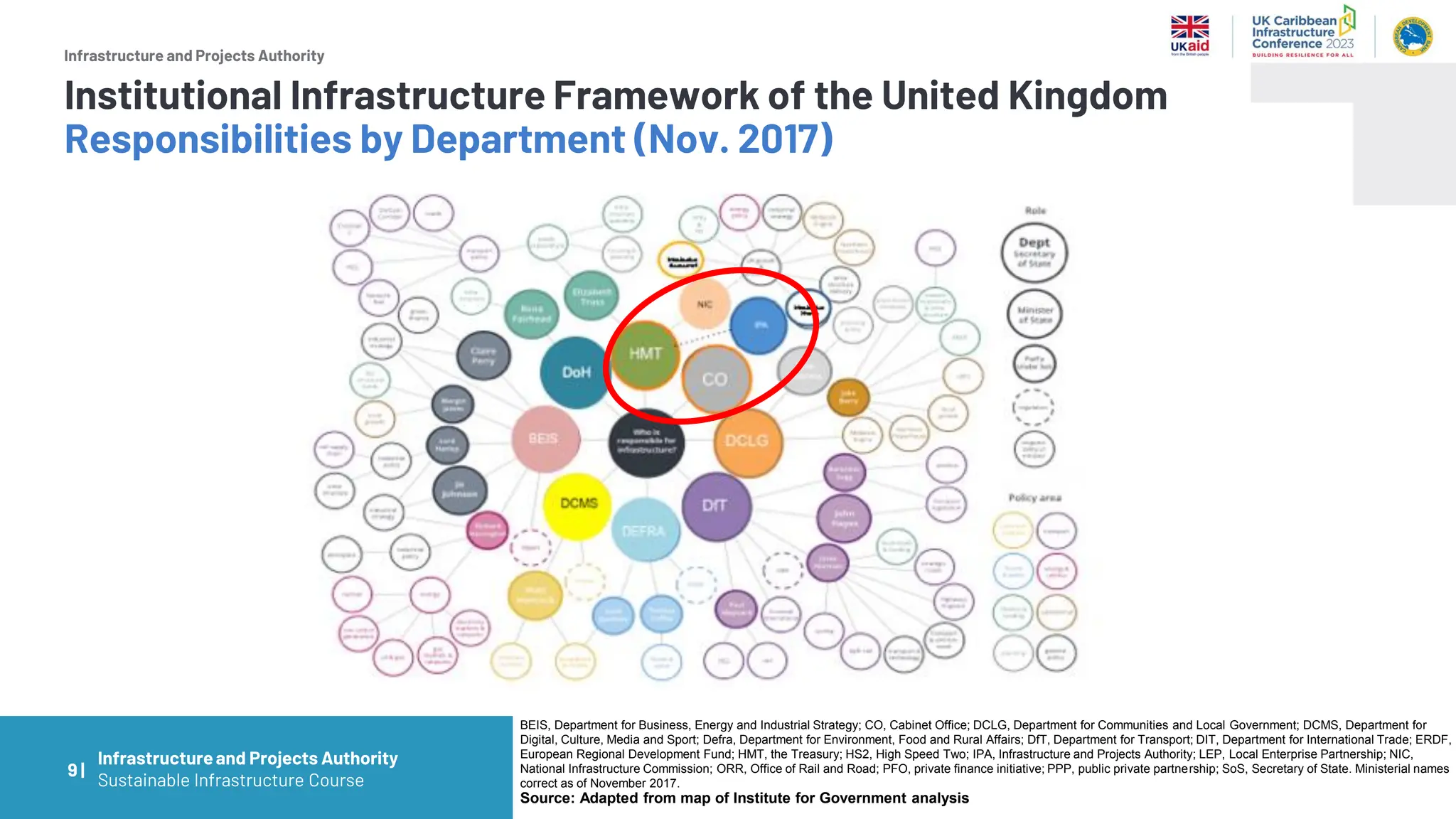

Institutional Infrastructure Framework of the United Kingdom
Responsibilities by Department (Nov. 2017)
9 |
Infrastructureand Projects Authority
Sustainable Infrastructure Course
Infrastructure and Projects Authority

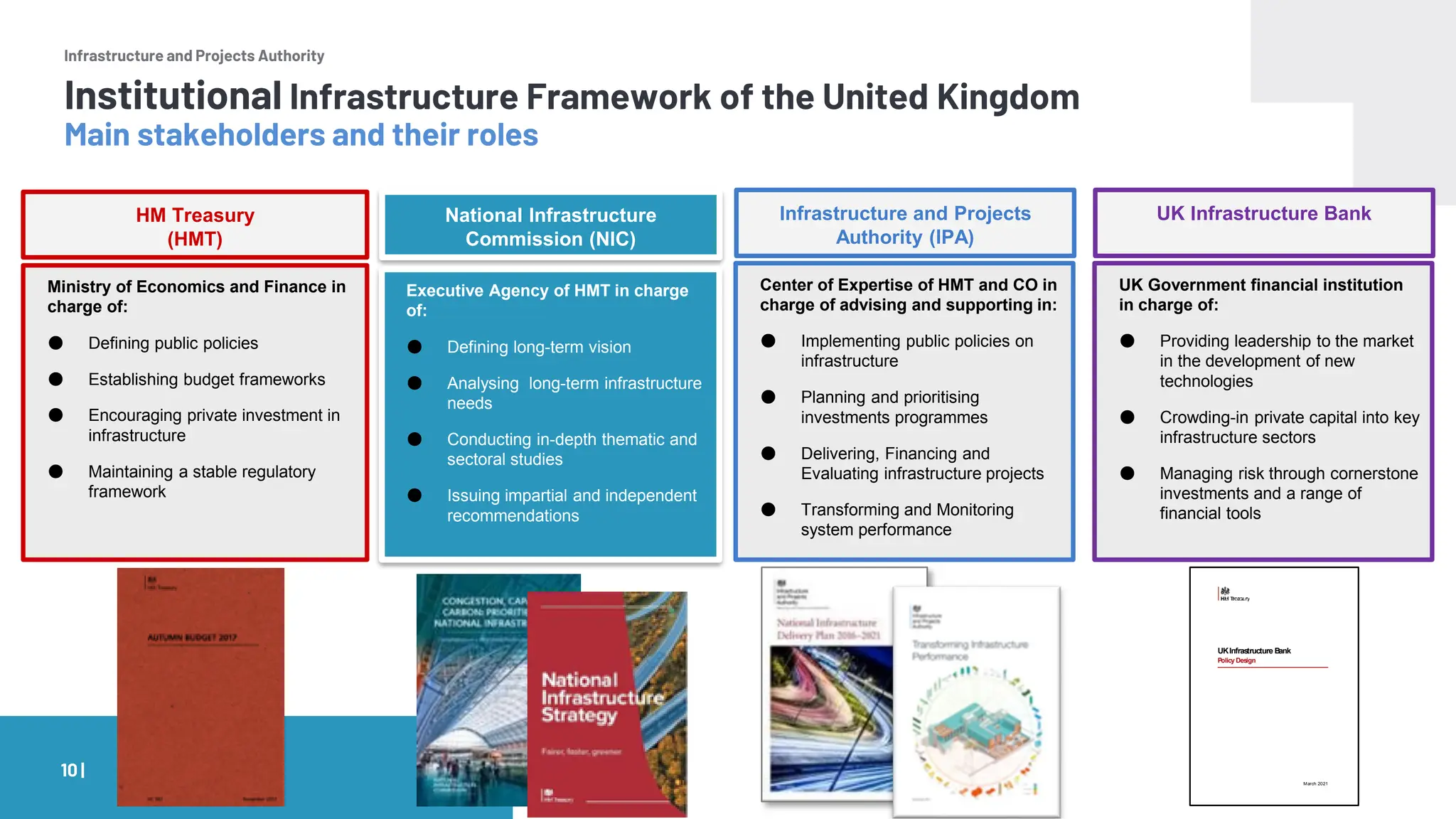

HM Treasury
(HMT)
National Infrastructure
Commission (NIC)
Executive Agency of HMT in charge
of:
● Defining long-term vision
● Analysing long-term infrastructure
needs
● Conducting in-depth thematic and
sectoral studies
● Issuing impartial and independent
recommendations
Ministry of Economics and Finance in
charge of:
● Defining public policies
● Establishing budget frameworks
● Encouraging private investment in
infrastructure
● Maintaining a stable regulatory
framework
Center of Expertise of HMT and CO in
charge of advising and supporting in:
● Implementing public policies on
infrastructure
● Planning and prioritising
investments programmes
● Delivering, Financing and
Evaluating infrastructure projects
● Transforming and Monitoring
system performance
Infrastructure and Projects
Authority (IPA)
Institutional Infrastructure Framework of the United Kingdom
Main stakeholders and their roles
10 |
UK Government financial institution
in charge of:
● Providing leadership to the market
in the development of new
technologies
● Crowding-in private capital into key
infrastructure sectors
● Managing risk through cornerstone
investments and a range of
financial tools
UK Infrastructure Bank
UKInfrastructure B
ank
Policy Design
March 2021

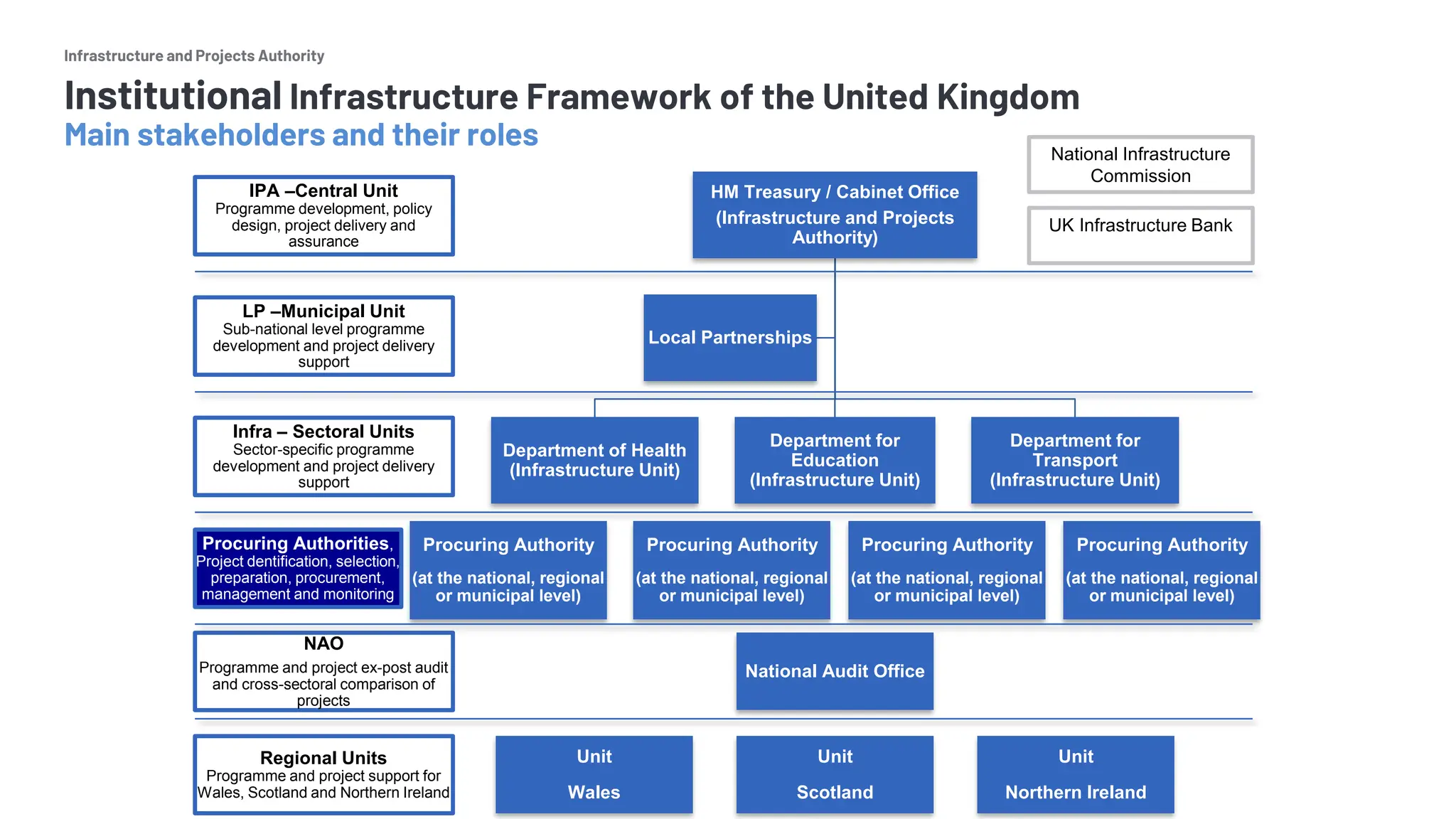

Infrastructure and Projects Authority
HM Treasury / Cabinet Office
(Infrastructure and Projects
Authority)
Department of Health
(Infrastructure Unit)
Department for
Education
(Infrastructure Unit)
Department for
Transport
(Infrastructure Unit)
Local Partnerships
Procuring Authority
(at the national, regional
or municipal level)
Procuring Authority
(at the national, regional
or municipal level)
Procuring Authority
(at the national, regional
or municipal level)
Procuring Authority
(at the national, regional
or municipal level)
National Audit Office
Unit
Wales
Unit
Scotland
Unit
Northern Ireland
IPA –Central Unit
Programme development, policy
design, project delivery and
assurance
LP –Municipal Unit
Sub-national level programme
development and project delivery
support
Infra – Sectoral Units
Sector-specific programme
development and project delivery
support
Procuring Authorities,
Project dentification, selection,
preparation, procurement,
management and monitoring
NAO
Programme and project ex-post audit
and cross-sectoral comparison of
projects
Regional Units
Programme and project support for
Wales, Scotland and Northern Ireland
National Infrastructure
Commission
Institutional Infrastructure Framework of the United Kingdom
Main stakeholders and their roles
UK Infrastructure Bank
Infrastructure and Projects Authority
Differences PUK IUK IPA
Structure JV 51% priv / 49% pub 100% HMT owned unit JV 50% HMT / 50% CO
Location outside Gov. HMT HMT
Operating model charging model free at the point of use (exc. Int’l). free at the point of use (exc. Int’l)
Scope PPPs Infrastructure Infra and Major Projects
Role Delivery Policy, Planning, Delivery, Policy, Planning, Delivery,
& Financing Finance & Assurance
Similarities PUK IUK IPA
Mission Public Public Public
Staff Public-Private Public-Private Public-Private
Employees 70 80+ 160
Skills 100% commercial 70% comm. - 30% policy 60 comm. / 40% policy
Contractual terms Sim. To Private Sector Comm. Specialist Grade Comm. Specialist Grade
2000-2010 2010 – 2016 2016 - ?
12 |

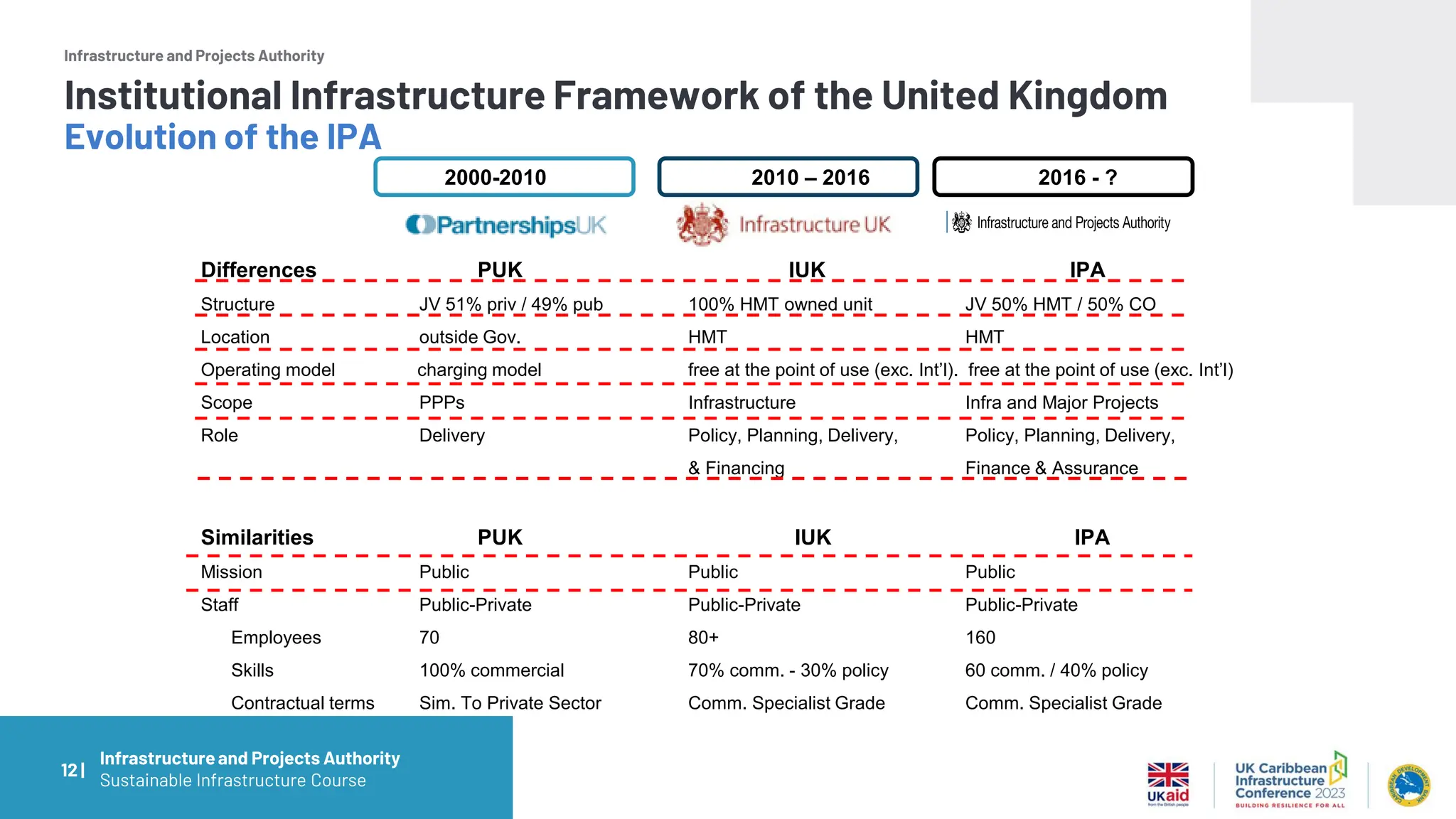

Institutional Infrastructure Framework of the United Kingdom
Evolution of the IPA
Infrastructureand Projects Authority
Sustainable Infrastructure Course
Infrastructure and Projects Authority

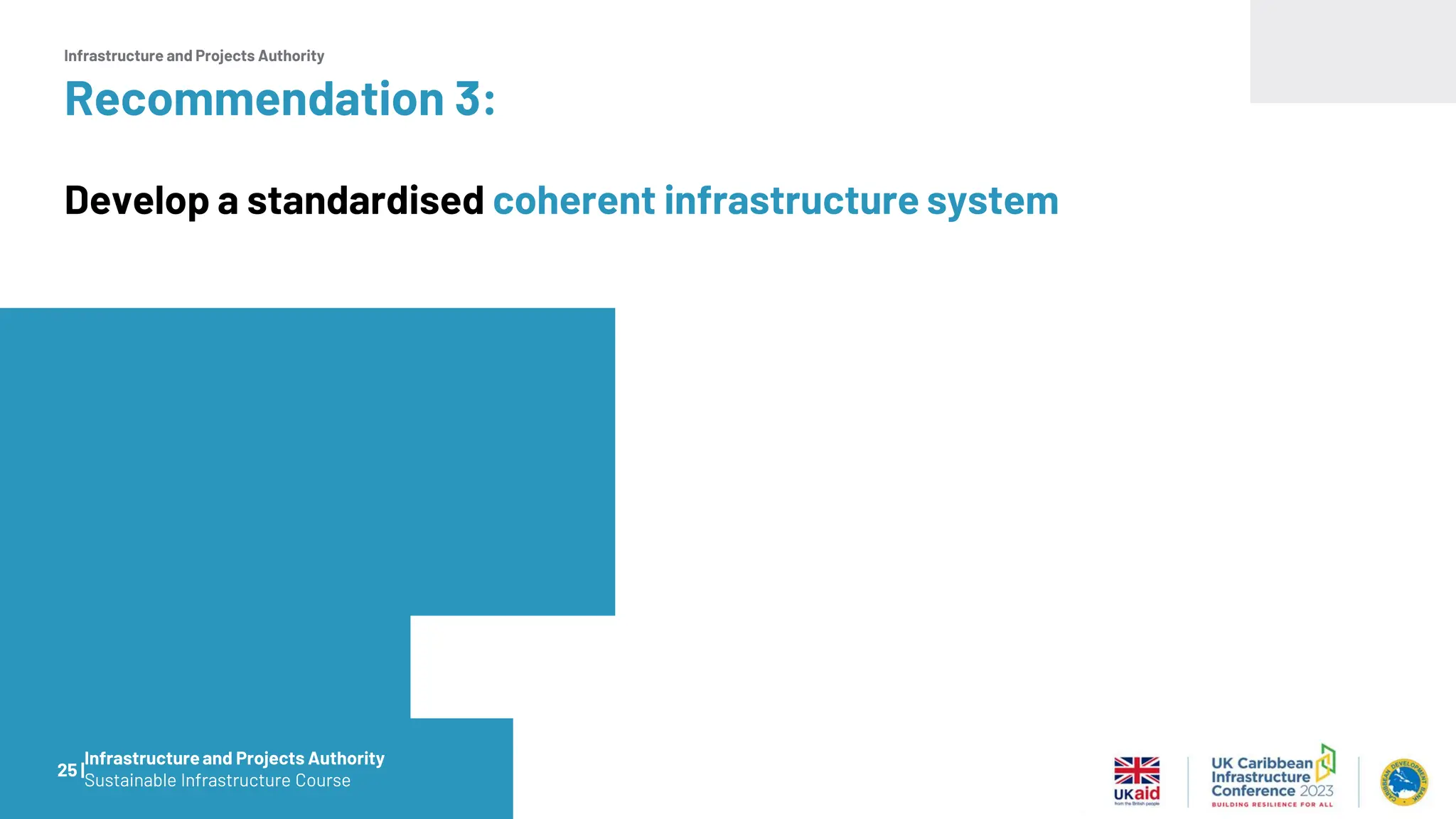

Recommendation 2:
Adopt a whole project lifecycle aproach to infrastructure development:
from planning and prioritisation through to delivery and contract
management
13 |
Infrastructureand Projects Authority
Sustainable Infrastructure Course
Infrastructure and Projects Authority

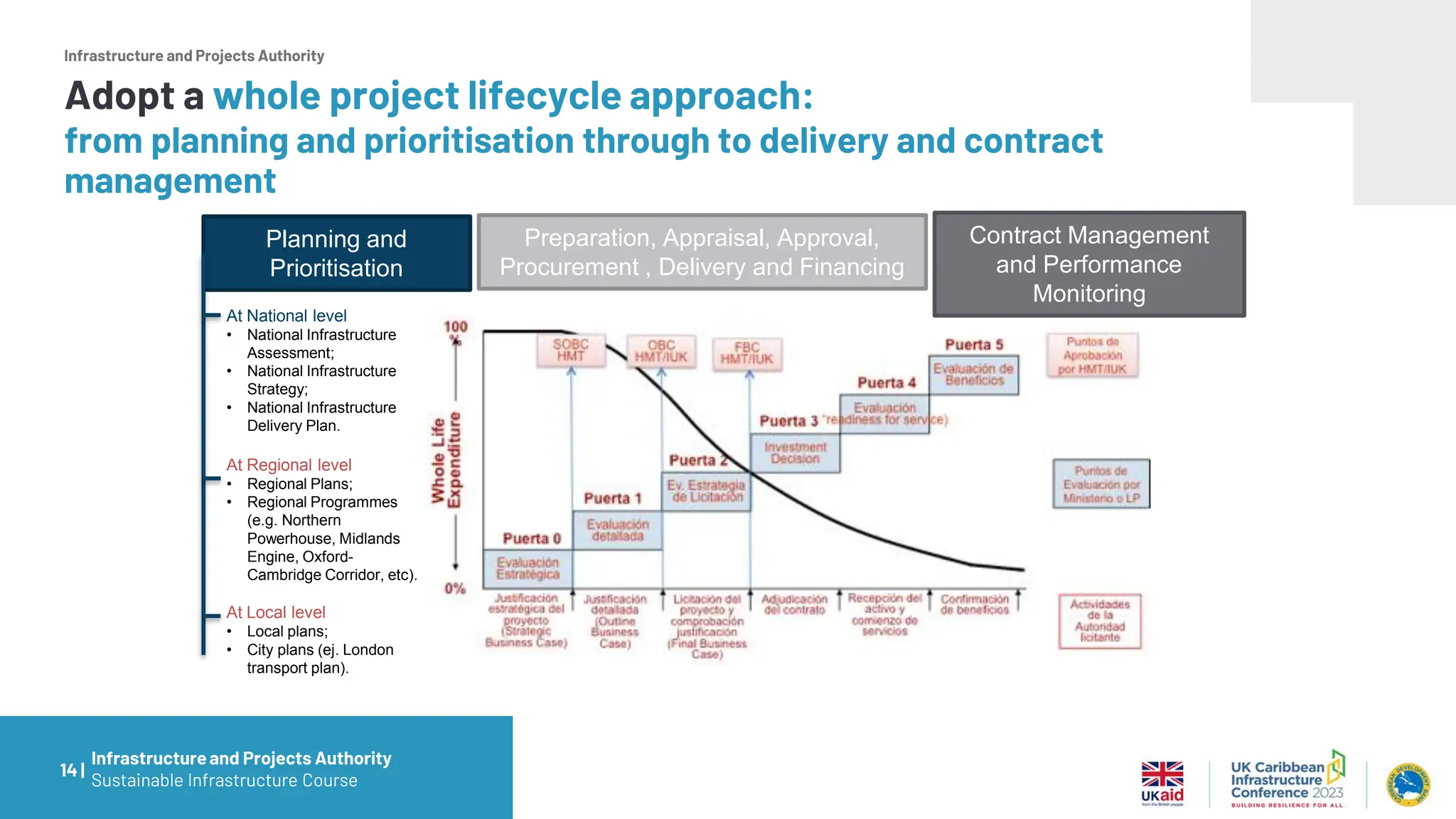

Planning and
Prioritisation
Preparation, Appraisal, Approval,
Procurement , Delivery and Financing
Contract Management
and Performance
Monitoring
At National level
• National Infrastructure
Assessment;
• National Infrastructure
Strategy;
• National Infrastructure
Delivery Plan.
At Regional level
• Regional Plans;
• Regional Programmes
(e.g. Northern
Powerhouse, Midlands
Engine, Oxford-
Cambridge Corridor, etc).
At Local level
• Local plans;
• City plans (ej. London
transport plan).
Adopt a whole project lifecycle approach:
from planning and prioritisation through to delivery and contract
management
14 |
Infrastructureand Projects Authority
Sustainable Infrastructure Course
Infrastructure and Projects Authority

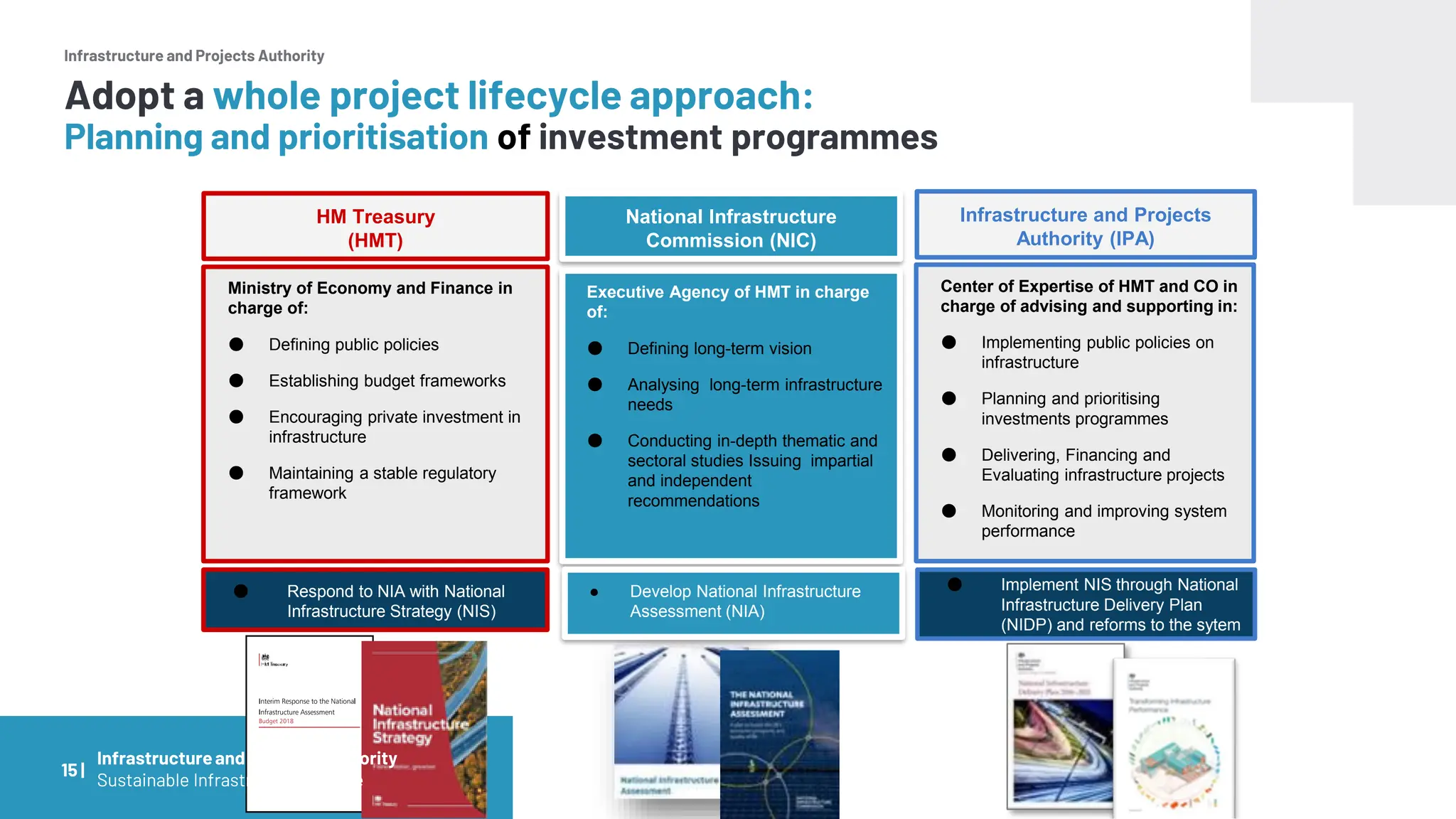

HM Treasury
(HMT)
National Infrastructure
Commission (NIC)
Executive Agency of HMT in charge
of:
● Defining long-term vision
● Analysing long-term infrastructure
needs
● Conducting in-depth thematic and
sectoral studies Issuing impartial
and independent
recommendations
Ministry of Economy and Finance in
charge of:
● Defining public policies
● Establishing budget frameworks
● Encouraging private investment in
infrastructure
● Maintaining a stable regulatory
framework
Center of Expertise of HMT and CO in
charge of advising and supporting in:
● Implementing public policies on
infrastructure
● Planning and prioritising
investments programmes
● Delivering, Financing and
Evaluating infrastructure projects
● Monitoring and improving system
performance
Infrastructure and Projects
Authority (IPA)
Adopt a whole project lifecycle approach:
Planning and prioritisation of investment programmes
● Respond to NIA with National
Infrastructure Strategy (NIS)
● Develop National Infrastructure
Assessment (NIA)
● Implement NIS through National
Infrastructure Delivery Plan
(NIDP) and reforms to the sytem
15 |
Infrastructureand Projects Authority
Sustainable Infrastructure Course
Infrastructure and Projects Authority

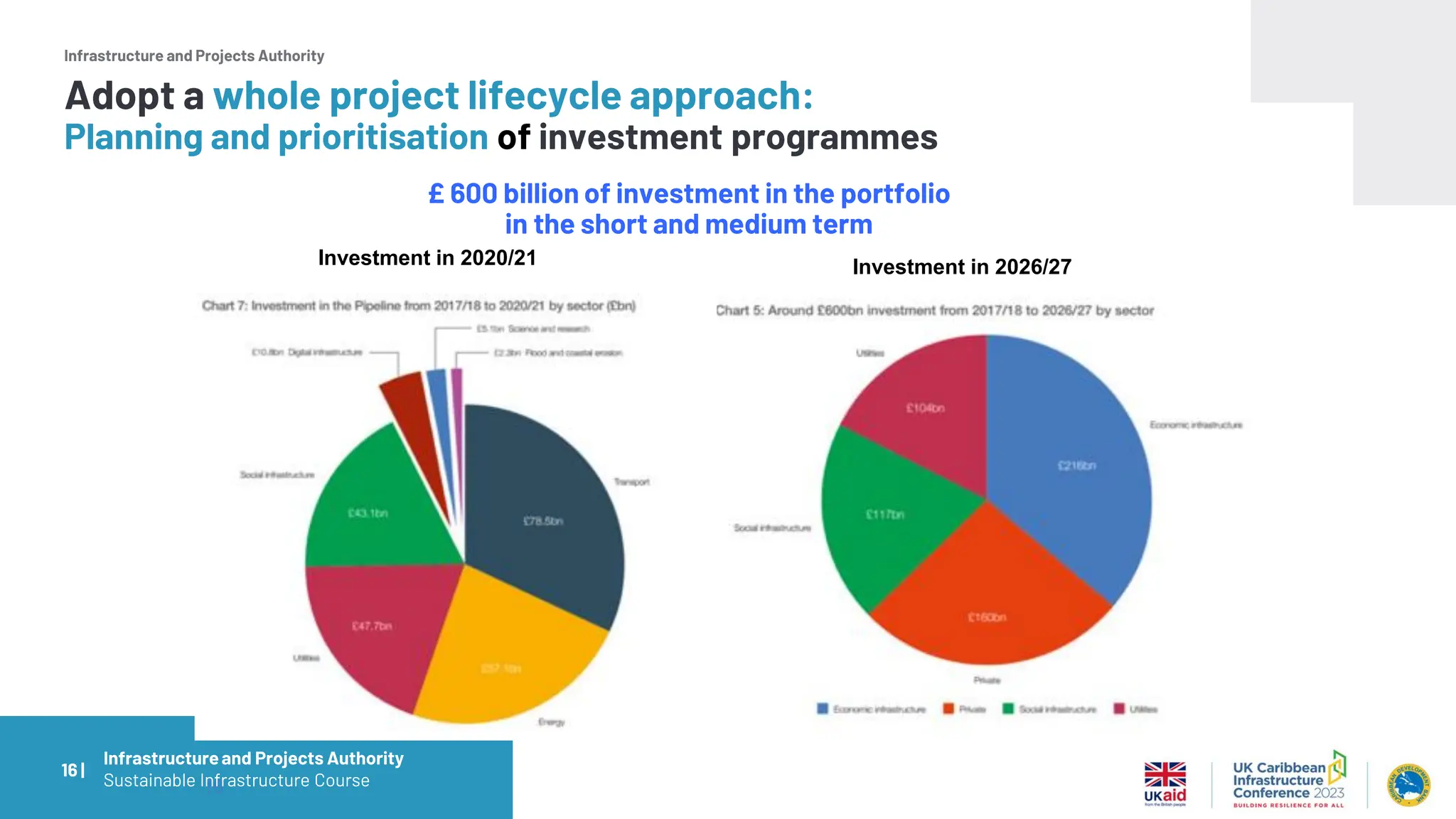

£ 600 billion of investment in the portfolio
in the short and medium term
16

Investment in 2020/21 Investment in 2026/27
16 |
Adopt a whole project lifecycle approach:
Planning and prioritisation of investment programmes
Infrastructureand Projects Authority
Sustainable Infrastructure Course
Infrastructure and Projects Authority

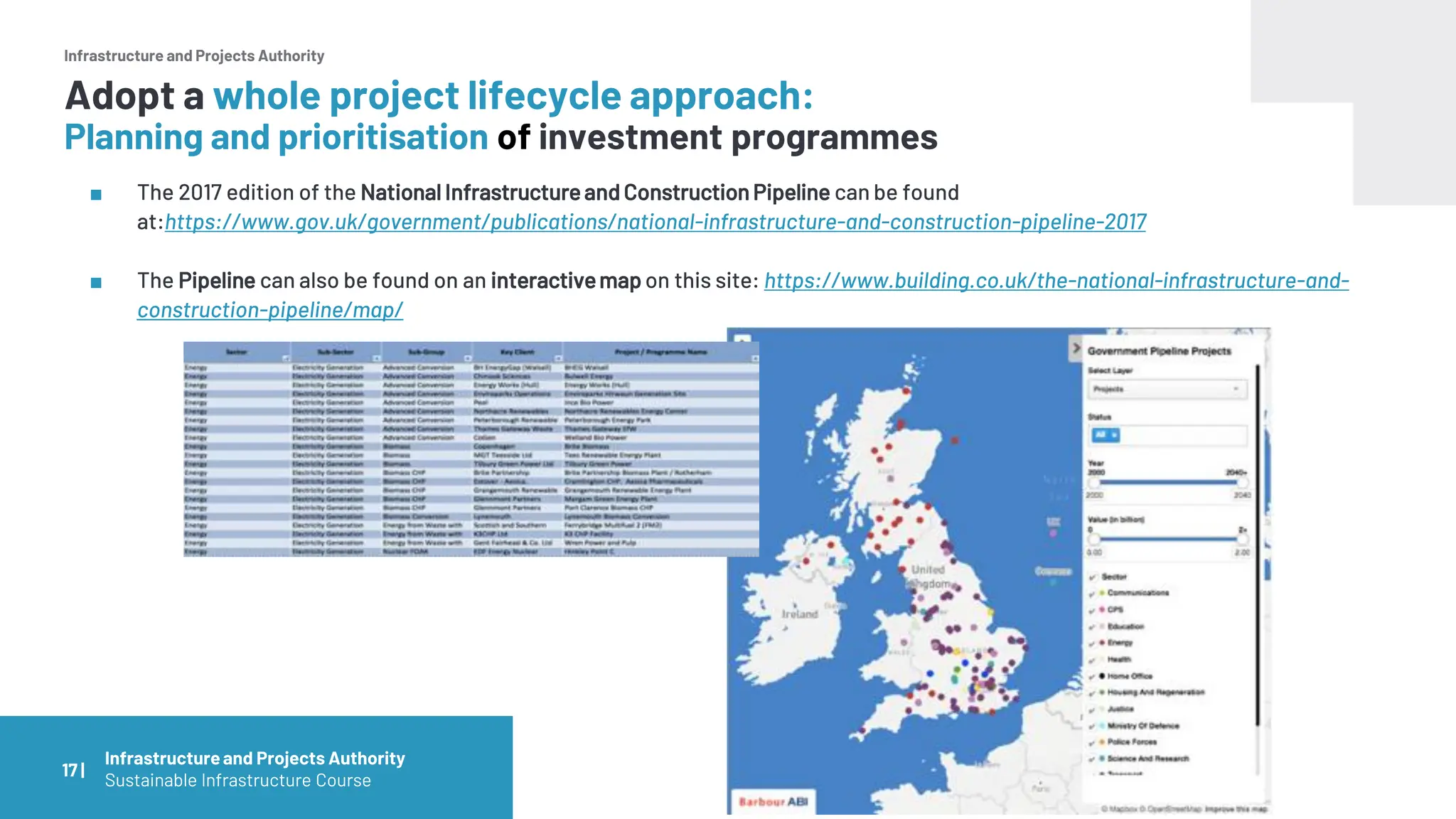

■ The 2017 edition of the National Infrastructureand Construction Pipeline can be found
at:https://www.gov.uk/government/publications/national-infrastructure-and-construction-pipeline-2017
■ The Pipeline can also be found on an interactivemap on this site: https://www.building.co.uk/the-national-infrastructure-and-
construction-pipeline/map/
17 |
Adopt a whole project lifecycle approach:
Planning and prioritisation of investment programmes
Infrastructureand Projects Authority
Sustainable Infrastructure Course
Infrastructure and Projects Authority
Planning and
Prioritisation
Preparation, Appraisal, Approval,
Procurement and Delivery
Contract Management and
Performance Monitoring
At National level
• National Infrastructure
Assessment;
• National Infrastructure
Strategy;
• National Infrastructure
Delivery Plan.
At Regional level
• Regional Plans;
• Regional Programmes
(e.g. Northern
Powerhouse, Midlands
Engine, Oxford-
Cambridge Corridor, etc).
At Local level
• Local plans;
• City plans (ej. London
transport plan).
18 |

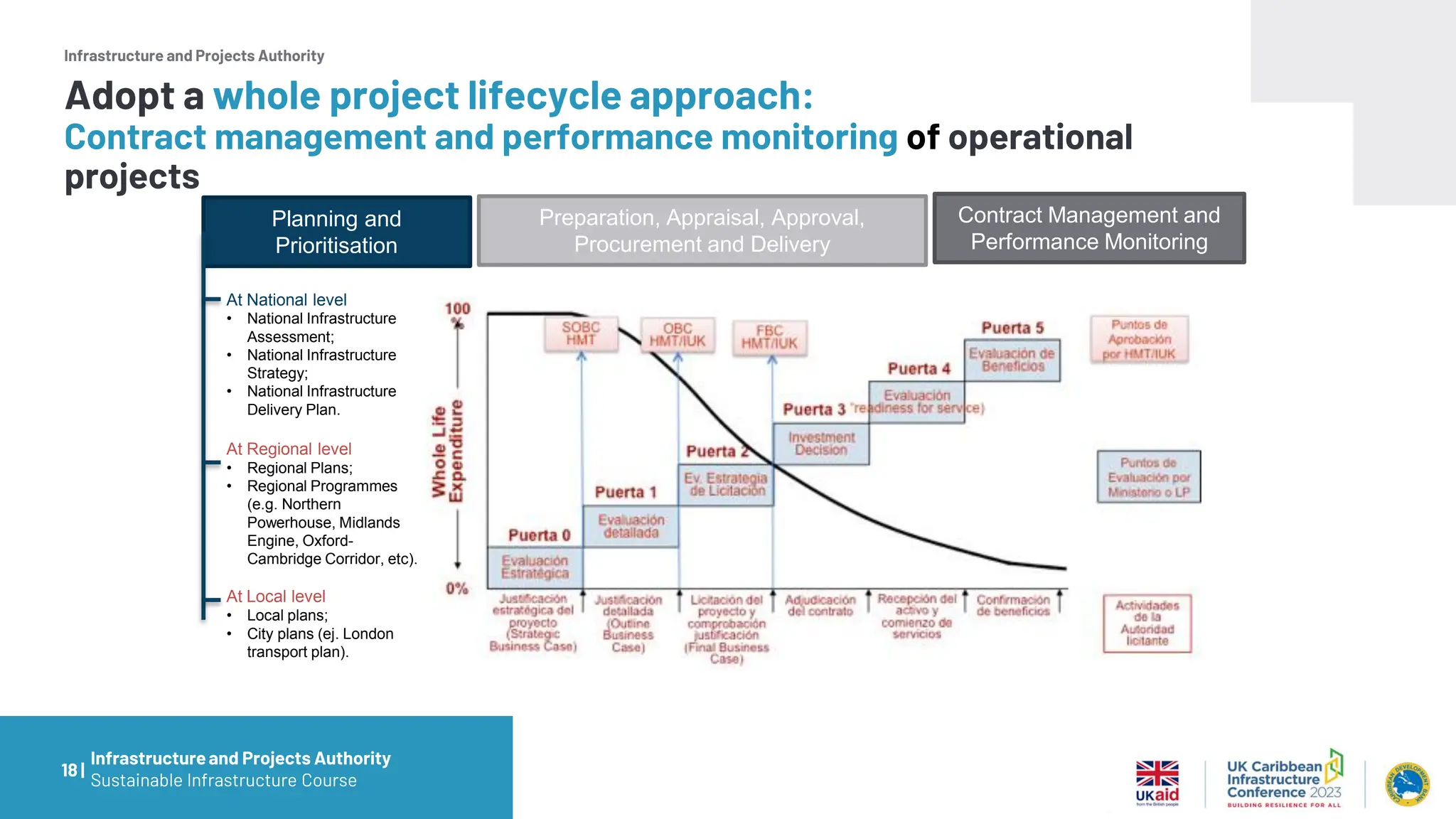

Adopt a whole project lifecycle approach:

Contract management and performance monitoring of operational
projects
Infrastructureand Projects Authority
Sustainable Infrastructure Course

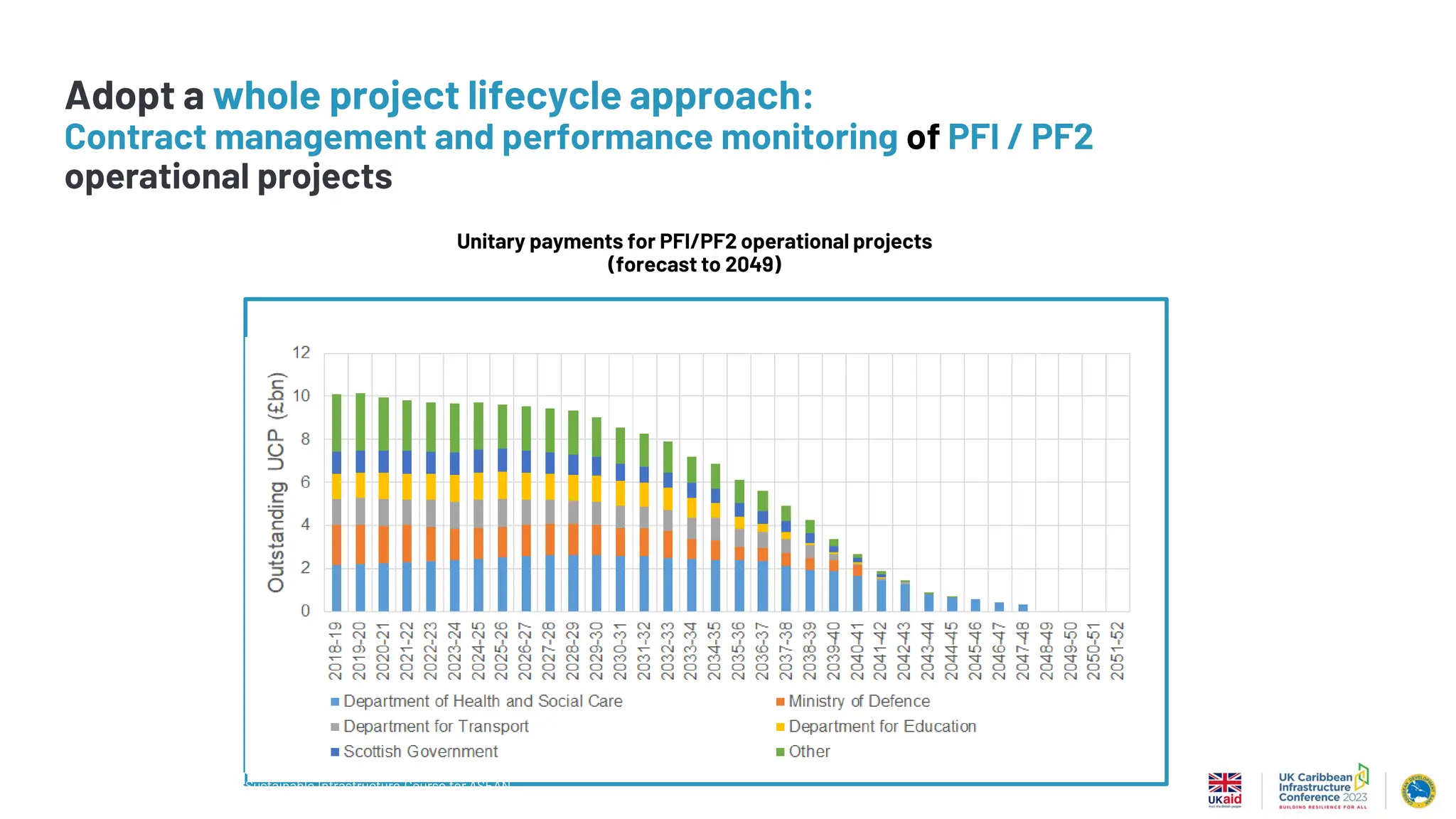

Unitary payments for PFI/PF2 operational projects
(forecast to 2049)
Source: IPA Data Base
*
19 |
Infrastructure and Projects Authority
Sustainable Infrastructure Course for ASEAN
Adopt a whole project lifecycle approach:
Contract management and performance monitoring of PFI / PF2
operational projects
Business As Usual Contract Expiry and Handback Future Services Delivery
● Gestionar activos y
servicios de acuerdo con
las obligaciones
contractuales.
● Mantener escrutinio de la
calidad y precisión de la
documentación.
● Generar conciencia para
cerrar cualquier disputa /
deficiencia, como falta de
mantenimiento acumulado
(backlog).
● Enfocarse en las fallas de
desempeño repetidas y las
consecuencias al
reemplazo del ciclo de
vida
● Establecer un equipo de vencimiento de contrato
● Revisar pasivos pendientes
● Asegurar el conocimiento de la documentación, los
activos y los sistemas que se devolverán.
● Determinar la solidez del contrato, los requisitos de
devolución del contrato y las soluciones disponibles
para generar un valor óptimo al vencimiento.
● Acordar estándares y medidas para la encuesta de
condición de los activos e instalaciones
● Revisar el informe de la encuesta de condición y
llegar a un acuerdo sobre el camino a seguir
● Negociar obras correctivas y / o compensaciones.
● Acordar la metodología para evaluar y aceptar el
trabajo completado
● Copnsiderar compromisos de recursos humanos:
transferencia de personal, pensiones, contratación de
nuevo personal, etc.
● Revisar las opciones según el
futuro de los activos y
servicios.
● Seleccionar los marcos
adecuados para la
contratación de servicios
● Desarrollar especificaciones
de servicios y KPI para los
servicios subcontratados.
● Diseñar un proceso
transparente de
adquisiciones
● Garantizar la continuidad de
los servicios e implementar la
transferencia de la prestación
de servicios y las
responsabilidades de gestión
de activos.
● Desarrollar una nueva
estructura de equipo y
responsabilidades.
Key functions for the management of PFI/PF2 operational projects – 7 years before hand back
20 |
Infrastructure and Projects Authority
Sustainable Infrastructure Course for ASEAN
Adopt a whole project lifecycle approach:
IPA central support to Contract management and performance
monitoring of PFI / PF2 operational projects
Infrastructure and Projects Authority
95% of the infrastructure we need is already here, with us
21 |
Adopt a whole project lifecycle approach:
Measurement, improvement and transformation of results (outputs)
Infrastructureand Projects Authority
Sustainable Infrastructure Course
Infrastructure and Projects Authority

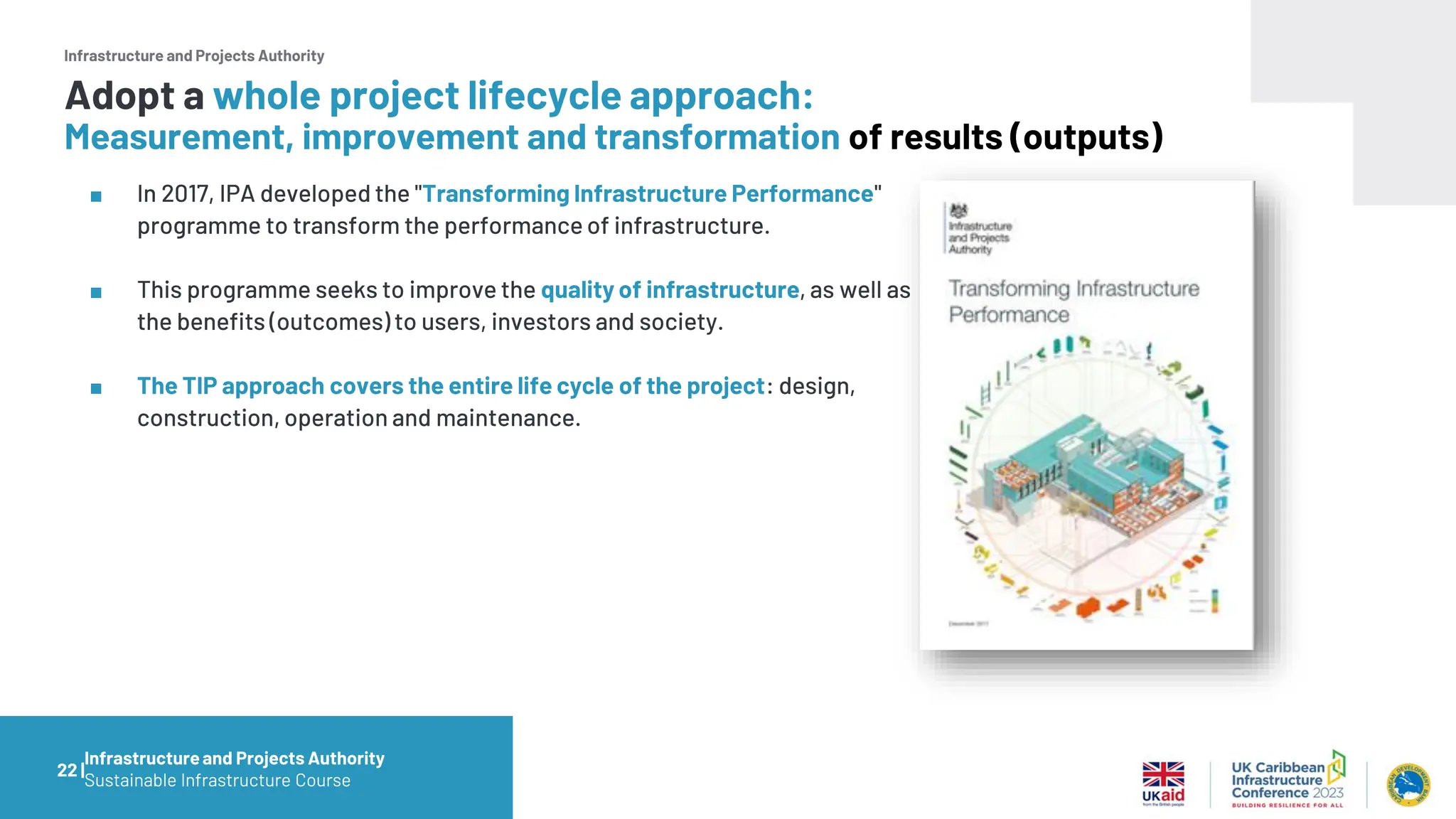

■ In 2017, IPA developed the "Transforming Infrastructure Performance"
programme to transform the performance of infrastructure.
■ This programme seeks to improve the quality of infrastructure, as well as
the benefits (outcomes) to users, investors and society.
■ The TIP approach covers the entire life cycle of the project: design,
construction, operation and maintenance.

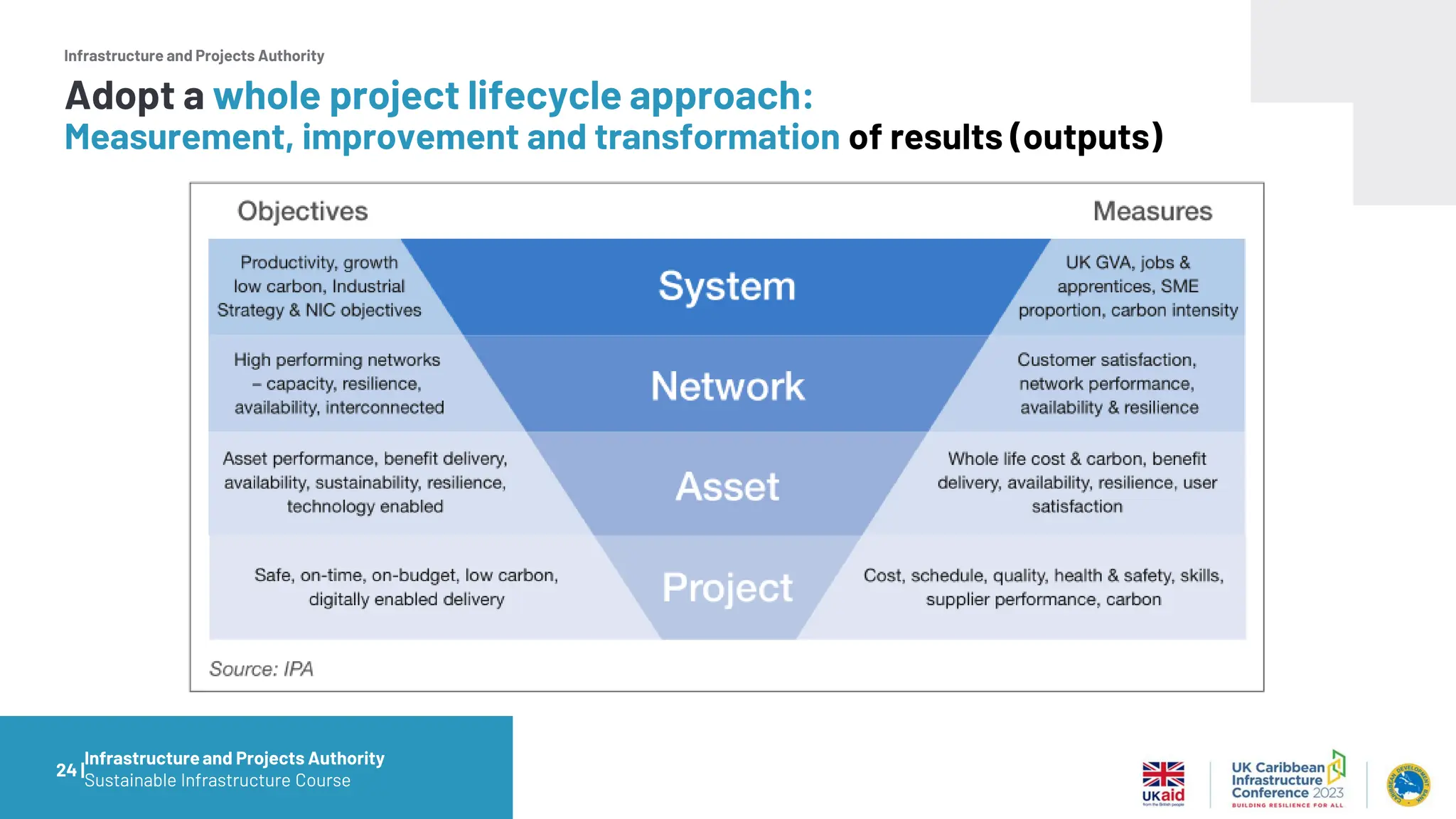

22 |
Adopt a whole project lifecycle approach:
Measurement, improvement and transformation of results (outputs)
Infrastructureand Projects Authority
Sustainable Infrastructure Course
Infrastructure and Projects Authority

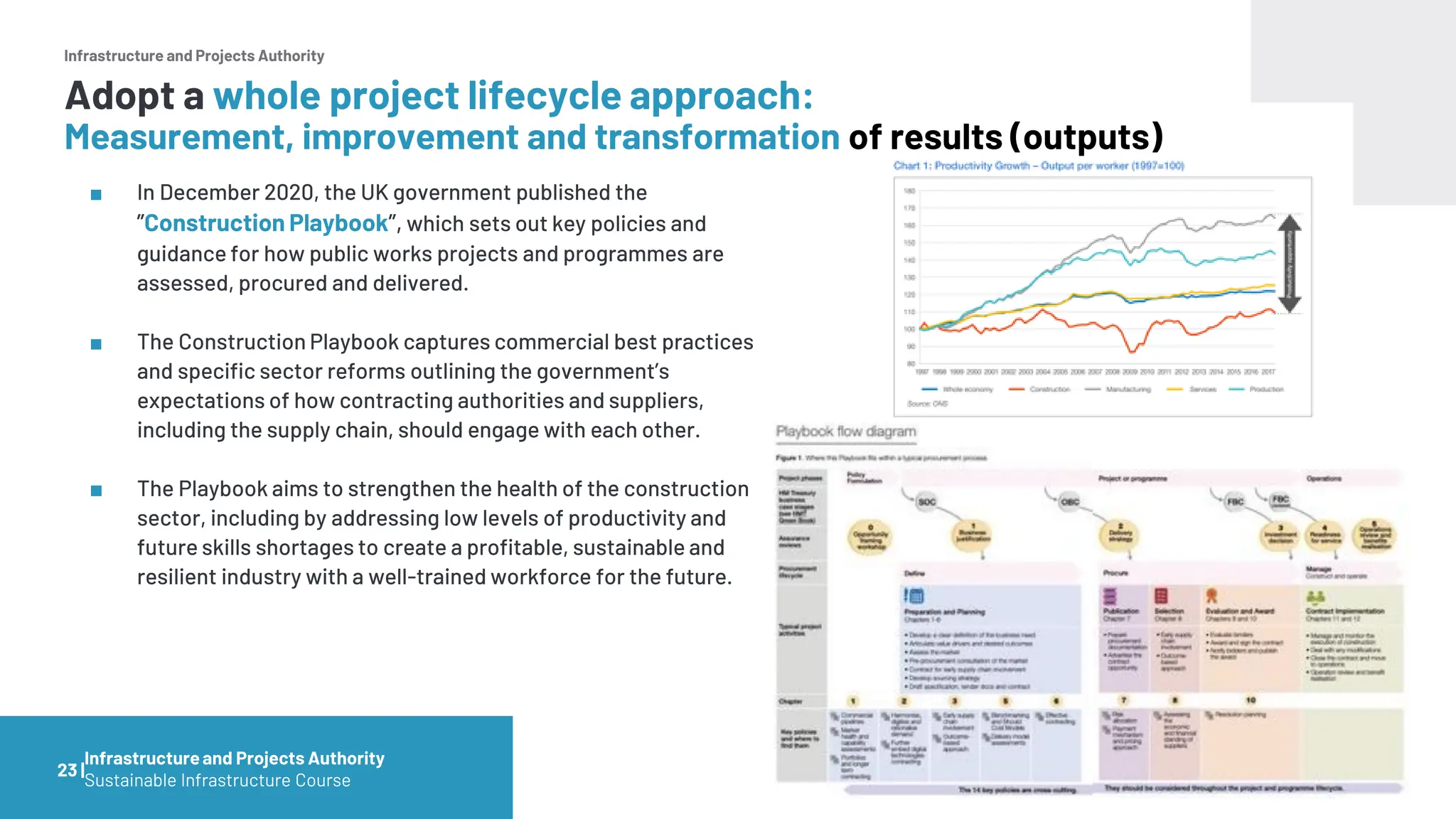

■ In December 2020, the UK government published the
”Construction Playbook”, which sets out key policies and
guidance for how public works projects and programmes are
assessed, procured and delivered.
■ The Construction Playbook captures commercial best practices
and specific sector reforms outlining the government’s
expectations of how contracting authorities and suppliers,
including the supply chain, should engage with each other.
■ The Playbook aims to strengthen the health of the construction
sector, including by addressing low levels of productivity and
future skills shortages to create a profitable, sustainable and
resilient industry with a well-trained workforce for the future.
23 |
Adopt a whole project lifecycle approach:
Measurement, improvement and transformation of results (outputs)
Infrastructureand Projects Authority
Sustainable Infrastructure Course
Infrastructure and Projects Authority
24 |
Adopt a whole project lifecycle approach:
Measurement, improvement and transformation of results (outputs)
Infrastructureand Projects Authority
Sustainable Infrastructure Course
Infrastructure and Projects Authority
Recommendation 3:
Develop a standardised coherent infrastructure system
25 |
Infrastructureand Projects Authority
Sustainable Infrastructure Course
Infrastructure and Projects Authority

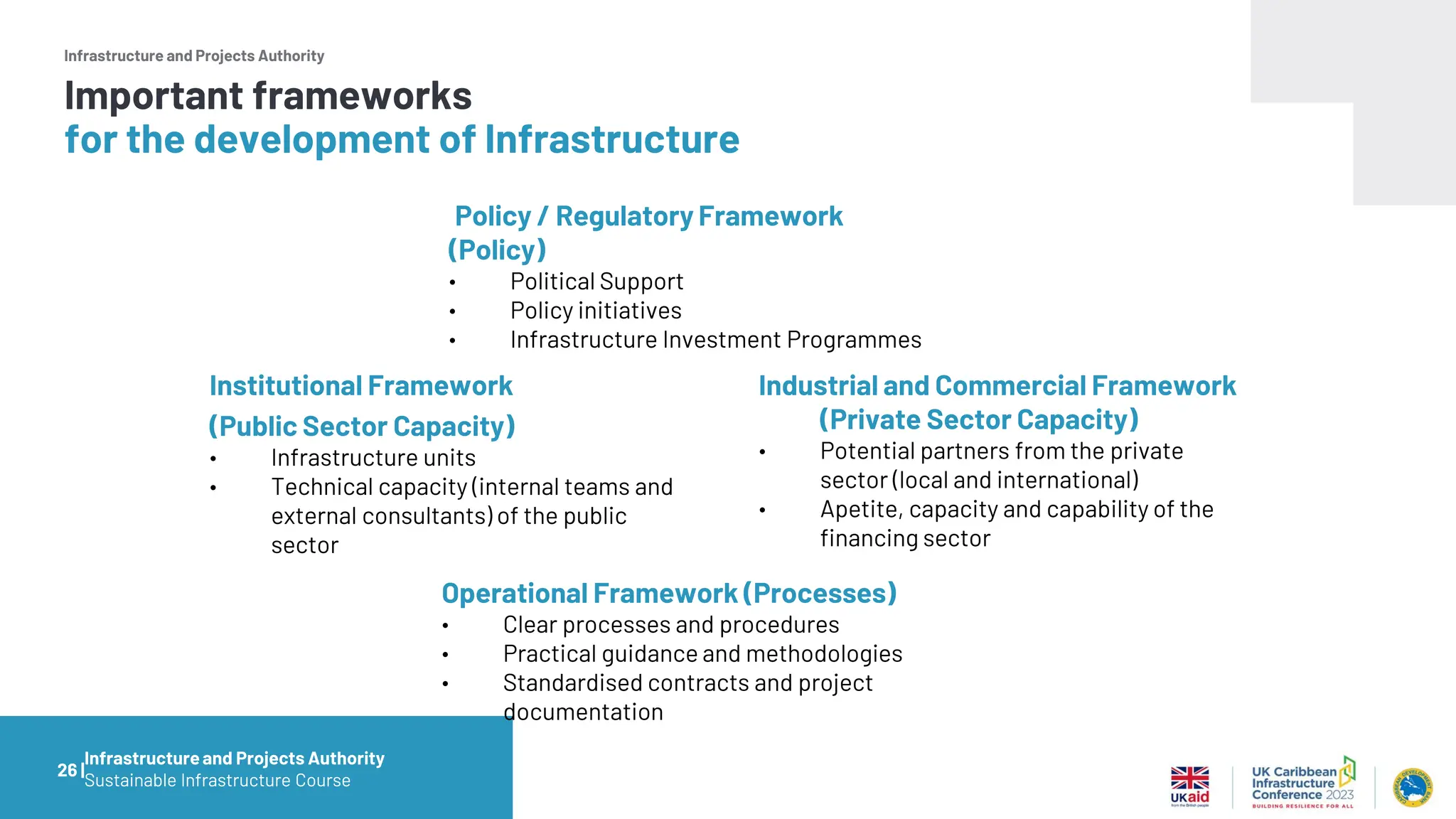

Policy / Regulatory Framework
(Policy)
• Political Support
• Policy initiatives
• Infrastructure Investment Programmes
Institutional Framework
(Public Sector Capacity)
• Infrastructure units
• Technical capacity (internal teams and
external consultants) of the public
sector
Industrial and Commercial Framework
(Private Sector Capacity)
• Potential partners from the private
sector (local and international)
• Apetite, capacity and capability of the
financing sector
Operational Framework (Processes)
• Clear processes and procedures
• Practical guidance and methodologies
• Standardised contracts and project
documentation
26 |
Important frameworks
for the development of Infrastructure
Infrastructureand Projects Authority
Sustainable Infrastructure Course
Infrastructure and Projects Authority
Strategic Outline
Case (SOC)
Outline Business
Case (OBC)
Full Business
Case (FBC)
Confirmed
FBC
Procurement
Live
Procurement
Live
Project
Identifie
d
Financial
Close
S1 S2 S3 O1 O2 O3 P1 F1 F2 F3 P2 C1 C2
P3
O2
SOC OBC
FBC
In the United Kingdom, project information (costs, times, quality, benefits) of both PPP and public works
projects (and even private projects), from all sectors, is captured in a structured, systematic way, from
credible sources, throughout the life cycle of the project, through a transparent operational framework.
27 |
Develop a standardised & coherent infrastructure system
with clear processes and procedures
Infrastructureand Projects Authority
Sustainable Infrastructure Course
Infrastructure and Projects Authority

Text
PIR
NIDP
5CM
NIDP
PIR
5CM
Project Initiation Routemap
“How do we set ourselves up to
successfully deliver projects?
Five Case Model
“How do we demonstrate that projects
are socially beneficial, desirable,
affordable, bankable and deliverable ?”
National Infrastructure Plan, Construction
Pipeline and Delivery Plan
“What infrastructure do we need to develop?
Where and when?”
28 |
Develop a standardised & coherent infrastructure system
with standard guidance, project documentation and tools for project
initiation, preparation, appraisal and approval
Infrastructureand Projects Authority
Sustainable Infrastructure Course
Infrastructure and Projects Authority

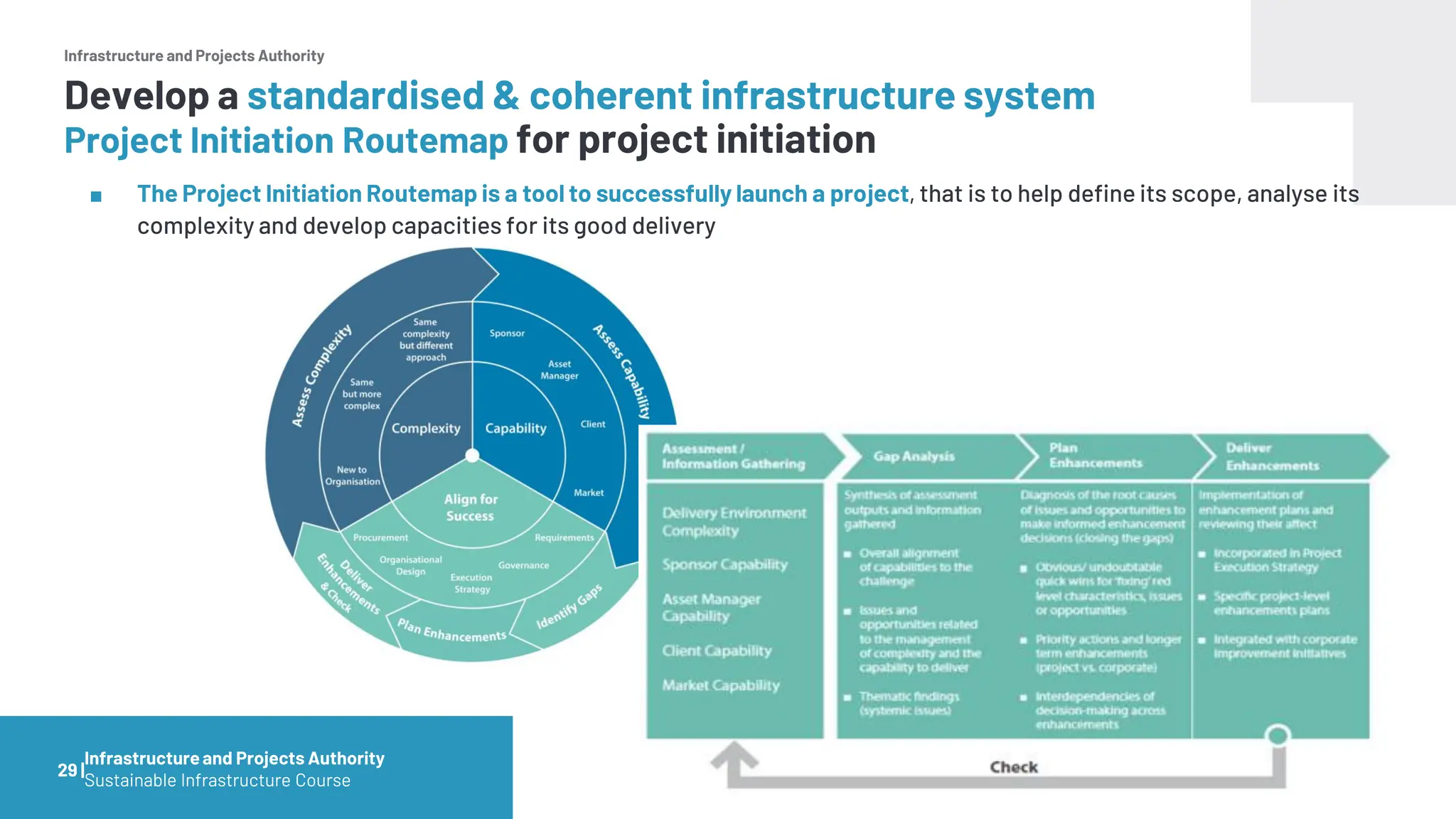

■ The Project Initiation Routemap is a tool to successfully launch a project, that is to help define its scope, analyse its
complexity and develop capacities for its good delivery
29 |
Develop a standardised & coherent infrastructure system
Project Initiation Routemap for project initiation
Infrastructureand Projects Authority
Sustainable Infrastructure Course
Infrastructure and Projects Authority
The 5 Case model is a multidimensional
methodology for the preparation, appraisal and
approval of investment proposals, including
infrastructure programmes and projects. Its
objective is to ensure that all approved projects are
necessary, desirable, bankable, affordable and
deliverable
Is the project
deliverable with the
resources in time,
money and personnel
that the authority has?
Is the project financially
affordable?
Is the project commercially
bankable?
Is the project
desirable from a
Value for money
standpoint?
Is the project necessary
from a social stand
point?
30 |

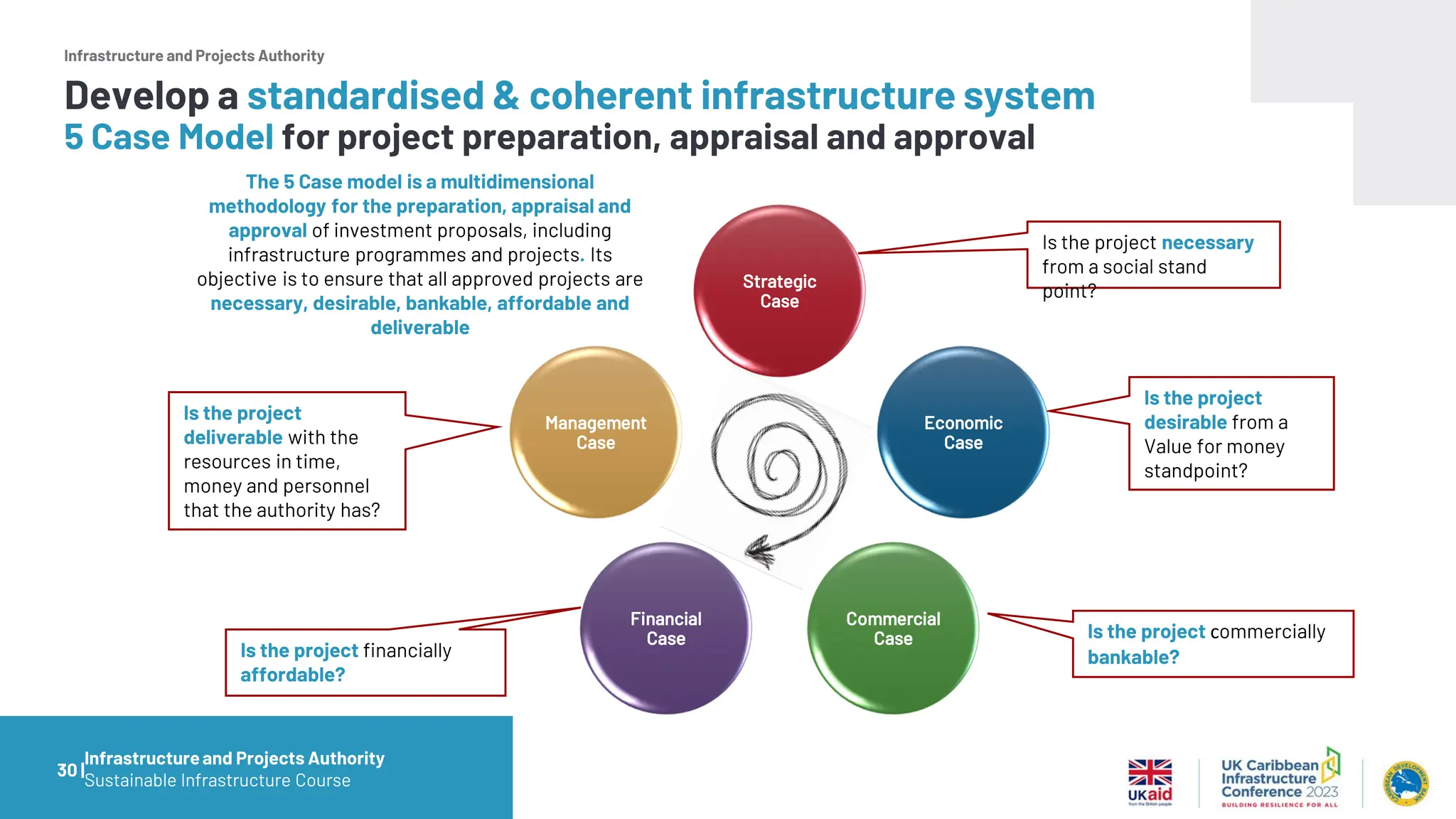

Develop a standardised & coherent infrastructure system
5 Case Model for project preparation, appraisal and approval
Strategic
Case
Economic
Case
Commercial
Case
Financial
Case
Management
Case
Infrastructureand Projects Authority
Sustainable Infrastructure Course
Infrastructure and Projects Authority
Strategic Outline
Case (SOC)
Outline Business
Case (OBC)
Full Business
Case (FBC)
Confirmed
FBC
Procurement
Live
Procurement
Live
Project
Identifie
d
Financial
Close
S1 S2 S3 O1 O2 O3 P1 F1 F2 F3 P2 C1 C2
P3
O2
SOC OBC
FBC
In the United Kingdom, project information (costs, times, quality, benefits) of both PPP and public works
projects (and even private projects), from all sectors, is captured in a structured, systematic way, from
credible sources, throughout the life cycle of the project, through a transparent operational framework.
35 |
Develop a standardised & coherent infrastructure system

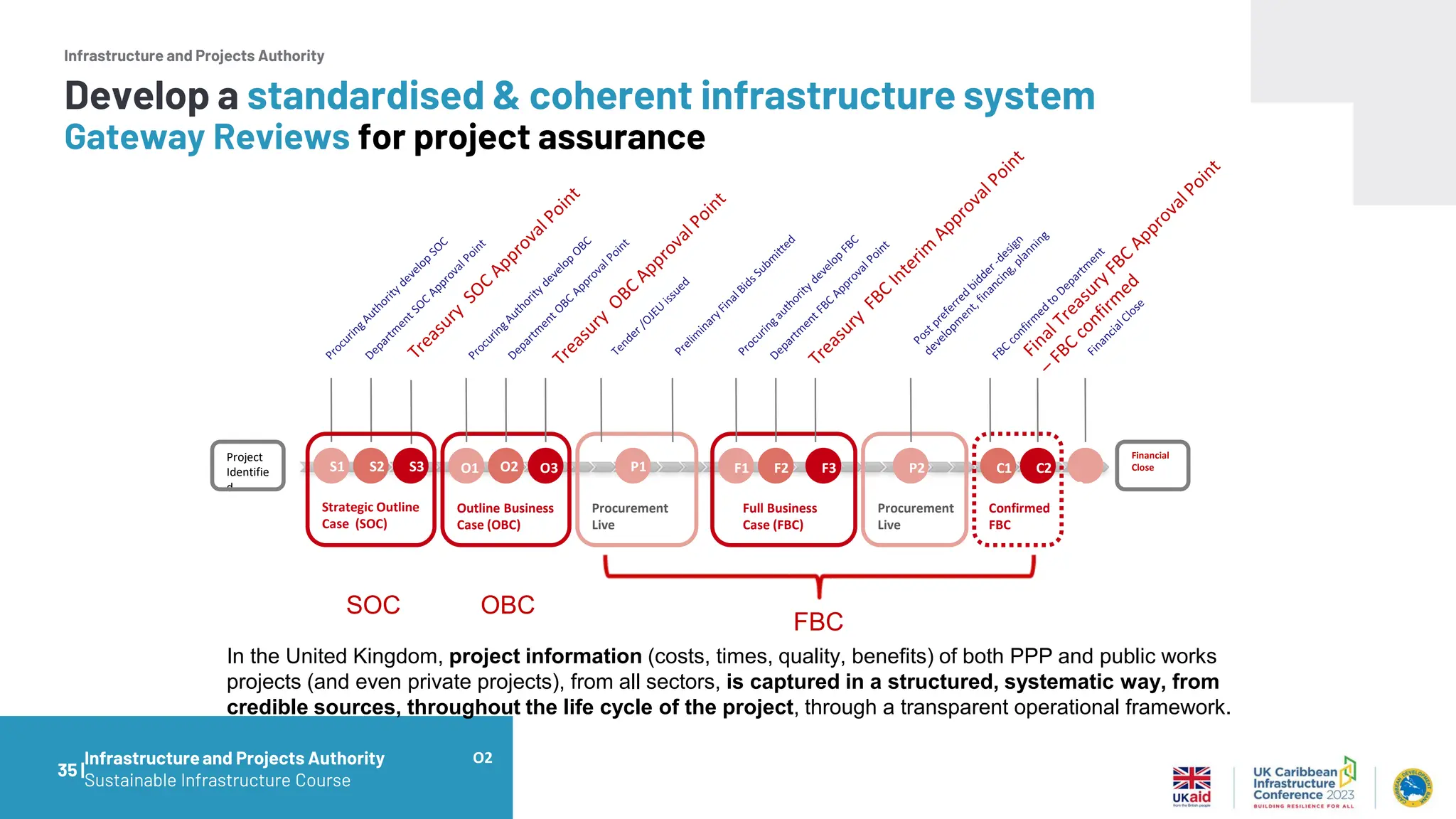

Gateway Reviews for project assurance
Infrastructureand Projects Authority
Sustainable Infrastructure Course
Infrastructure and Projects Authority
Lessons Learned
■ The United Kingdom has learned over the past 20 years that it is important to:
▪ Develop a solid and flexible institutional framework that can evolve and adapt to the needs and characteristics of the country.
▪ Adopt a whole life cycle approach for the development of infrastructure. The project preparation and delivery processes are only
two links within the long life cycle of the infrastructure.
▪ Go upstream: plan your infrastructure investment and prioritise (temporarily, sectorally and geographically) your project pipeline.
▪ Go downstream: measure, monitor and manage the performance of (cost, time, quality, benefits and impact) of your operational
projects.
▪ Align planning, delivery and contract management . Planning without delivery is bad theory, delivery without planning and
operational management is bad practice.
▪ Develop a flexible and coherent infrastructure system The infrastructure project life cycle is part of a system made up of
institutions, public policies, processes, procedures, programmes, projects and people.
▪ Standardise guidance, methodologies, contracts, project documentation to prepare, appraise, approve and deliver you
infrastructure programmes and projects.
36 |
Infrastructureand Projects Authority
Sustainable Infrastructure Course
Infrastructure and Projects Authority
Transforming Infrastructure Performance
■ https://youtu.be/qmbx00k38iA
Kahoot! Quizz
Infrastructure and Projects Authority
Questions about this session
■ Howimportant are the topicscovered in thissession foryour country?
▪ Not important
▪ Neutral
▪ important
▪ Very important
■ Howusefulare the tools and concepts presentedin this sessionfor your organisation?
▪ Not useful
▪ Neutral
▪ Useful
▪ Very useful
■ Which typeof activity is most usefulto expand your knowledgeon the topicscovered in this session?
▪ Seminars
▪ Training
▪ Strategic Government to Government advisory support
▪ Transactional advisory support from the private sector
39 |Infrastructureand Projects Authority
Sustainable Infrastructure Course
Infrastructure and Projects Authority
Javier.Encinas1@ipa.gov.uk
40 |
Infrastructureand Projects Authority
Sustainable Infrastructure Course

UK Experience in Infrastructure Development: from planning and prioritisation through to delivery and monitoring.

  • 1.
    Infrastructure and ProjectsAuthority UK-Caribbean Infrastructure Conference 23 November 2023 St Vincent & the Grenadines
  • 2.
    UK Experience inInfrastructure Development: from planning and prioritisation through to delivery and monitoring. Javier Encinas Deputy Head of International Project and Structured Finance Group Infrastructure and Projects Authority HM Treasury and Cabinet Office UK-Caribbean Infrastructure Conference
  • 3.
    Infrastructure and ProjectsAuthority UK current and past infrastructure status 3 | Infrastructureand Projects Authority Sustainable Infrastructure Course
  • 4.
    Infrastructure and ProjectsAuthority UK Infrastructure Investment • Around 60% of the UK’s Infrastructure Pipeline` will be financed and delivered by the private sector. UK infrastructure sector investment from 2016/17 onwards • This equates to over £270 billion ($336 billion)` The UK is an attractive destination for investors. Nabarro LLP’s 2023 Infrastructure Index ranks the UK as the number one country for infrastructure investors. The UK is also a top 10 country for competitiveness and infrastructure in the World Economic Forum’s Global Competitiveness Index. 4 | Infrastructureand Projects Authority Sustainable Infrastructure Course Current situation of UK Infrastructure
  • 5.
    Infrastructure and ProjectsAuthority Situation of UK Infrastructure in the 1990s ■ Legacy of under- investment in Operation & Maintenance of the existing infrastructure stock ▪ Resulted in aging poorly maintained infrastructure ▪ Backlog of school repairs in 1997 estimated at £7billion ▪ Backlog of NHS building maintenance over £3billion ■ Legacy of under- investment in Greenfield social infrastructure projects ▪ Lack of investment in new schools, hospitals, social housing, etc. was holding back the country’s social development ■ Limitation of Government budget for investment in infrastructure ▪ Constrained capital budgets ▪ Constrained fiscal space ■ Limitation of the reach and efficiency of the traditional procurement route ▪ Conventional procurement resulted in time and cost overruns
  • 6.
    Infrastructure and ProjectsAuthority Traditional Procurement – Cost Overruns Guy’s Hospital Budget: £36m Guy’s Hospital Outturn: £124m Faslane Trident Submarine Berth Budget: £100m Faslane Trident Submarine Berth Outturn: £314m Scottish Parliament Budget: £40m Scottish Parliament Outturn: £431m
  • 7.
    Infrastructure and ProjectsAuthority Lessons learned in the UK and key recommendations 7 | Infrastructureand Projects Authority Sustainable Infrastructure Course
  • 8.
    Infrastructure and ProjectsAuthority Recommendation 1: Develop a solid and flexible institutional framework 8 | Infrastructureand Projects Authority Sustainable Infrastructure Course
  • 9.
    Infrastructure and ProjectsAuthority BEIS, Department for Business, Energy and Industrial Strategy; CO, Cabinet Office; DCLG, Department for Communities and Local Government; DCMS, Department for Digital, Culture, Media and Sport; Defra, Department for Environment, Food and Rural Affairs; DfT, Department for Transport; DIT, Department for International Trade; ERDF, European Regional Development Fund; HMT, the Treasury; HS2, High Speed Two; IPA, Infrastructure and Projects Authority; LEP, Local Enterprise Partnership; NIC, National Infrastructure Commission; ORR, Office of Rail and Road; PFO, private finance initiative; PPP, public private partnership; SoS, Secretary of State. Ministerial names correct as of November 2017. Source: Adapted from map of Institute for Government analysis Institutional Infrastructure Framework of the United Kingdom Responsibilities by Department (Nov. 2017) 9 | Infrastructureand Projects Authority Sustainable Infrastructure Course
  • 10.
    Infrastructure and ProjectsAuthority HM Treasury (HMT) National Infrastructure Commission (NIC) Executive Agency of HMT in charge of: ● Defining long-term vision ● Analysing long-term infrastructure needs ● Conducting in-depth thematic and sectoral studies ● Issuing impartial and independent recommendations Ministry of Economics and Finance in charge of: ● Defining public policies ● Establishing budget frameworks ● Encouraging private investment in infrastructure ● Maintaining a stable regulatory framework Center of Expertise of HMT and CO in charge of advising and supporting in: ● Implementing public policies on infrastructure ● Planning and prioritising investments programmes ● Delivering, Financing and Evaluating infrastructure projects ● Transforming and Monitoring system performance Infrastructure and Projects Authority (IPA) Institutional Infrastructure Framework of the United Kingdom Main stakeholders and their roles 10 | UK Government financial institution in charge of: ● Providing leadership to the market in the development of new technologies ● Crowding-in private capital into key infrastructure sectors ● Managing risk through cornerstone investments and a range of financial tools UK Infrastructure Bank UKInfrastructure B ank Policy Design March 2021
  • 11.
    Infrastructure and ProjectsAuthority HM Treasury / Cabinet Office (Infrastructure and Projects Authority) Department of Health (Infrastructure Unit) Department for Education (Infrastructure Unit) Department for Transport (Infrastructure Unit) Local Partnerships Procuring Authority (at the national, regional or municipal level) Procuring Authority (at the national, regional or municipal level) Procuring Authority (at the national, regional or municipal level) Procuring Authority (at the national, regional or municipal level) National Audit Office Unit Wales Unit Scotland Unit Northern Ireland IPA –Central Unit Programme development, policy design, project delivery and assurance LP –Municipal Unit Sub-national level programme development and project delivery support Infra – Sectoral Units Sector-specific programme development and project delivery support Procuring Authorities, Project dentification, selection, preparation, procurement, management and monitoring NAO Programme and project ex-post audit and cross-sectoral comparison of projects Regional Units Programme and project support for Wales, Scotland and Northern Ireland National Infrastructure Commission Institutional Infrastructure Framework of the United Kingdom Main stakeholders and their roles UK Infrastructure Bank
  • 12.
    Infrastructure and ProjectsAuthority Differences PUK IUK IPA Structure JV 51% priv / 49% pub 100% HMT owned unit JV 50% HMT / 50% CO Location outside Gov. HMT HMT Operating model charging model free at the point of use (exc. Int’l). free at the point of use (exc. Int’l) Scope PPPs Infrastructure Infra and Major Projects Role Delivery Policy, Planning, Delivery, Policy, Planning, Delivery, & Financing Finance & Assurance Similarities PUK IUK IPA Mission Public Public Public Staff Public-Private Public-Private Public-Private Employees 70 80+ 160 Skills 100% commercial 70% comm. - 30% policy 60 comm. / 40% policy Contractual terms Sim. To Private Sector Comm. Specialist Grade Comm. Specialist Grade 2000-2010 2010 – 2016 2016 - ? 12 | Institutional Infrastructure Framework of the United Kingdom Evolution of the IPA Infrastructureand Projects Authority Sustainable Infrastructure Course
  • 13.
    Infrastructure and ProjectsAuthority Recommendation 2: Adopt a whole project lifecycle aproach to infrastructure development: from planning and prioritisation through to delivery and contract management 13 | Infrastructureand Projects Authority Sustainable Infrastructure Course
  • 14.
    Infrastructure and ProjectsAuthority Planning and Prioritisation Preparation, Appraisal, Approval, Procurement , Delivery and Financing Contract Management and Performance Monitoring At National level • National Infrastructure Assessment; • National Infrastructure Strategy; • National Infrastructure Delivery Plan. At Regional level • Regional Plans; • Regional Programmes (e.g. Northern Powerhouse, Midlands Engine, Oxford- Cambridge Corridor, etc). At Local level • Local plans; • City plans (ej. London transport plan). Adopt a whole project lifecycle approach: from planning and prioritisation through to delivery and contract management 14 | Infrastructureand Projects Authority Sustainable Infrastructure Course
  • 15.
    Infrastructure and ProjectsAuthority HM Treasury (HMT) National Infrastructure Commission (NIC) Executive Agency of HMT in charge of: ● Defining long-term vision ● Analysing long-term infrastructure needs ● Conducting in-depth thematic and sectoral studies Issuing impartial and independent recommendations Ministry of Economy and Finance in charge of: ● Defining public policies ● Establishing budget frameworks ● Encouraging private investment in infrastructure ● Maintaining a stable regulatory framework Center of Expertise of HMT and CO in charge of advising and supporting in: ● Implementing public policies on infrastructure ● Planning and prioritising investments programmes ● Delivering, Financing and Evaluating infrastructure projects ● Monitoring and improving system performance Infrastructure and Projects Authority (IPA) Adopt a whole project lifecycle approach: Planning and prioritisation of investment programmes ● Respond to NIA with National Infrastructure Strategy (NIS) ● Develop National Infrastructure Assessment (NIA) ● Implement NIS through National Infrastructure Delivery Plan (NIDP) and reforms to the sytem 15 | Infrastructureand Projects Authority Sustainable Infrastructure Course
  • 16.
    Infrastructure and ProjectsAuthority £ 600 billion of investment in the portfolio in the short and medium term 16 Investment in 2020/21 Investment in 2026/27 16 | Adopt a whole project lifecycle approach: Planning and prioritisation of investment programmes Infrastructureand Projects Authority Sustainable Infrastructure Course
  • 17.
    Infrastructure and ProjectsAuthority ■ The 2017 edition of the National Infrastructureand Construction Pipeline can be found at:https://www.gov.uk/government/publications/national-infrastructure-and-construction-pipeline-2017 ■ The Pipeline can also be found on an interactivemap on this site: https://www.building.co.uk/the-national-infrastructure-and- construction-pipeline/map/ 17 | Adopt a whole project lifecycle approach: Planning and prioritisation of investment programmes Infrastructureand Projects Authority Sustainable Infrastructure Course
  • 18.
    Infrastructure and ProjectsAuthority Planning and Prioritisation Preparation, Appraisal, Approval, Procurement and Delivery Contract Management and Performance Monitoring At National level • National Infrastructure Assessment; • National Infrastructure Strategy; • National Infrastructure Delivery Plan. At Regional level • Regional Plans; • Regional Programmes (e.g. Northern Powerhouse, Midlands Engine, Oxford- Cambridge Corridor, etc). At Local level • Local plans; • City plans (ej. London transport plan). 18 | Adopt a whole project lifecycle approach: Contract management and performance monitoring of operational projects Infrastructureand Projects Authority Sustainable Infrastructure Course
  • 19.
    Unitary payments forPFI/PF2 operational projects (forecast to 2049) Source: IPA Data Base * 19 | Infrastructure and Projects Authority Sustainable Infrastructure Course for ASEAN Adopt a whole project lifecycle approach: Contract management and performance monitoring of PFI / PF2 operational projects
  • 20.
    Business As UsualContract Expiry and Handback Future Services Delivery ● Gestionar activos y servicios de acuerdo con las obligaciones contractuales. ● Mantener escrutinio de la calidad y precisión de la documentación. ● Generar conciencia para cerrar cualquier disputa / deficiencia, como falta de mantenimiento acumulado (backlog). ● Enfocarse en las fallas de desempeño repetidas y las consecuencias al reemplazo del ciclo de vida ● Establecer un equipo de vencimiento de contrato ● Revisar pasivos pendientes ● Asegurar el conocimiento de la documentación, los activos y los sistemas que se devolverán. ● Determinar la solidez del contrato, los requisitos de devolución del contrato y las soluciones disponibles para generar un valor óptimo al vencimiento. ● Acordar estándares y medidas para la encuesta de condición de los activos e instalaciones ● Revisar el informe de la encuesta de condición y llegar a un acuerdo sobre el camino a seguir ● Negociar obras correctivas y / o compensaciones. ● Acordar la metodología para evaluar y aceptar el trabajo completado ● Copnsiderar compromisos de recursos humanos: transferencia de personal, pensiones, contratación de nuevo personal, etc. ● Revisar las opciones según el futuro de los activos y servicios. ● Seleccionar los marcos adecuados para la contratación de servicios ● Desarrollar especificaciones de servicios y KPI para los servicios subcontratados. ● Diseñar un proceso transparente de adquisiciones ● Garantizar la continuidad de los servicios e implementar la transferencia de la prestación de servicios y las responsabilidades de gestión de activos. ● Desarrollar una nueva estructura de equipo y responsabilidades. Key functions for the management of PFI/PF2 operational projects – 7 years before hand back 20 | Infrastructure and Projects Authority Sustainable Infrastructure Course for ASEAN Adopt a whole project lifecycle approach: IPA central support to Contract management and performance monitoring of PFI / PF2 operational projects
  • 21.
    Infrastructure and ProjectsAuthority 95% of the infrastructure we need is already here, with us 21 | Adopt a whole project lifecycle approach: Measurement, improvement and transformation of results (outputs) Infrastructureand Projects Authority Sustainable Infrastructure Course
  • 22.
    Infrastructure and ProjectsAuthority ■ In 2017, IPA developed the "Transforming Infrastructure Performance" programme to transform the performance of infrastructure. ■ This programme seeks to improve the quality of infrastructure, as well as the benefits (outcomes) to users, investors and society. ■ The TIP approach covers the entire life cycle of the project: design, construction, operation and maintenance. 22 | Adopt a whole project lifecycle approach: Measurement, improvement and transformation of results (outputs) Infrastructureand Projects Authority Sustainable Infrastructure Course
  • 23.
    Infrastructure and ProjectsAuthority ■ In December 2020, the UK government published the ”Construction Playbook”, which sets out key policies and guidance for how public works projects and programmes are assessed, procured and delivered. ■ The Construction Playbook captures commercial best practices and specific sector reforms outlining the government’s expectations of how contracting authorities and suppliers, including the supply chain, should engage with each other. ■ The Playbook aims to strengthen the health of the construction sector, including by addressing low levels of productivity and future skills shortages to create a profitable, sustainable and resilient industry with a well-trained workforce for the future. 23 | Adopt a whole project lifecycle approach: Measurement, improvement and transformation of results (outputs) Infrastructureand Projects Authority Sustainable Infrastructure Course
  • 24.
    Infrastructure and ProjectsAuthority 24 | Adopt a whole project lifecycle approach: Measurement, improvement and transformation of results (outputs) Infrastructureand Projects Authority Sustainable Infrastructure Course
  • 25.
    Infrastructure and ProjectsAuthority Recommendation 3: Develop a standardised coherent infrastructure system 25 | Infrastructureand Projects Authority Sustainable Infrastructure Course
  • 26.
    Infrastructure and ProjectsAuthority Policy / Regulatory Framework (Policy) • Political Support • Policy initiatives • Infrastructure Investment Programmes Institutional Framework (Public Sector Capacity) • Infrastructure units • Technical capacity (internal teams and external consultants) of the public sector Industrial and Commercial Framework (Private Sector Capacity) • Potential partners from the private sector (local and international) • Apetite, capacity and capability of the financing sector Operational Framework (Processes) • Clear processes and procedures • Practical guidance and methodologies • Standardised contracts and project documentation 26 | Important frameworks for the development of Infrastructure Infrastructureand Projects Authority Sustainable Infrastructure Course
  • 27.
    Infrastructure and ProjectsAuthority Strategic Outline Case (SOC) Outline Business Case (OBC) Full Business Case (FBC) Confirmed FBC Procurement Live Procurement Live Project Identifie d Financial Close S1 S2 S3 O1 O2 O3 P1 F1 F2 F3 P2 C1 C2 P3 O2 SOC OBC FBC In the United Kingdom, project information (costs, times, quality, benefits) of both PPP and public works projects (and even private projects), from all sectors, is captured in a structured, systematic way, from credible sources, throughout the life cycle of the project, through a transparent operational framework. 27 | Develop a standardised & coherent infrastructure system with clear processes and procedures Infrastructureand Projects Authority Sustainable Infrastructure Course
  • 28.
    Infrastructure and ProjectsAuthority Text PIR NIDP 5CM NIDP PIR 5CM Project Initiation Routemap “How do we set ourselves up to successfully deliver projects? Five Case Model “How do we demonstrate that projects are socially beneficial, desirable, affordable, bankable and deliverable ?” National Infrastructure Plan, Construction Pipeline and Delivery Plan “What infrastructure do we need to develop? Where and when?” 28 | Develop a standardised & coherent infrastructure system with standard guidance, project documentation and tools for project initiation, preparation, appraisal and approval Infrastructureand Projects Authority Sustainable Infrastructure Course
  • 29.
    Infrastructure and ProjectsAuthority ■ The Project Initiation Routemap is a tool to successfully launch a project, that is to help define its scope, analyse its complexity and develop capacities for its good delivery 29 | Develop a standardised & coherent infrastructure system Project Initiation Routemap for project initiation Infrastructureand Projects Authority Sustainable Infrastructure Course
  • 30.
    Infrastructure and ProjectsAuthority The 5 Case model is a multidimensional methodology for the preparation, appraisal and approval of investment proposals, including infrastructure programmes and projects. Its objective is to ensure that all approved projects are necessary, desirable, bankable, affordable and deliverable Is the project deliverable with the resources in time, money and personnel that the authority has? Is the project financially affordable? Is the project commercially bankable? Is the project desirable from a Value for money standpoint? Is the project necessary from a social stand point? 30 | Develop a standardised & coherent infrastructure system 5 Case Model for project preparation, appraisal and approval Strategic Case Economic Case Commercial Case Financial Case Management Case Infrastructureand Projects Authority Sustainable Infrastructure Course
  • 31.
    Infrastructure and ProjectsAuthority Strategic Outline Case (SOC) Outline Business Case (OBC) Full Business Case (FBC) Confirmed FBC Procurement Live Procurement Live Project Identifie d Financial Close S1 S2 S3 O1 O2 O3 P1 F1 F2 F3 P2 C1 C2 P3 O2 SOC OBC FBC In the United Kingdom, project information (costs, times, quality, benefits) of both PPP and public works projects (and even private projects), from all sectors, is captured in a structured, systematic way, from credible sources, throughout the life cycle of the project, through a transparent operational framework. 35 | Develop a standardised & coherent infrastructure system Gateway Reviews for project assurance Infrastructureand Projects Authority Sustainable Infrastructure Course
  • 32.
    Infrastructure and ProjectsAuthority Lessons Learned ■ The United Kingdom has learned over the past 20 years that it is important to: ▪ Develop a solid and flexible institutional framework that can evolve and adapt to the needs and characteristics of the country. ▪ Adopt a whole life cycle approach for the development of infrastructure. The project preparation and delivery processes are only two links within the long life cycle of the infrastructure. ▪ Go upstream: plan your infrastructure investment and prioritise (temporarily, sectorally and geographically) your project pipeline. ▪ Go downstream: measure, monitor and manage the performance of (cost, time, quality, benefits and impact) of your operational projects. ▪ Align planning, delivery and contract management . Planning without delivery is bad theory, delivery without planning and operational management is bad practice. ▪ Develop a flexible and coherent infrastructure system The infrastructure project life cycle is part of a system made up of institutions, public policies, processes, procedures, programmes, projects and people. ▪ Standardise guidance, methodologies, contracts, project documentation to prepare, appraise, approve and deliver you infrastructure programmes and projects. 36 | Infrastructureand Projects Authority Sustainable Infrastructure Course
  • 33.
    Infrastructure and ProjectsAuthority Transforming Infrastructure Performance ■ https://youtu.be/qmbx00k38iA
  • 34.
  • 35.
    Infrastructure and ProjectsAuthority Questions about this session ■ Howimportant are the topicscovered in thissession foryour country? ▪ Not important ▪ Neutral ▪ important ▪ Very important ■ Howusefulare the tools and concepts presentedin this sessionfor your organisation? ▪ Not useful ▪ Neutral ▪ Useful ▪ Very useful ■ Which typeof activity is most usefulto expand your knowledgeon the topicscovered in this session? ▪ Seminars ▪ Training ▪ Strategic Government to Government advisory support ▪ Transactional advisory support from the private sector 39 |Infrastructureand Projects Authority Sustainable Infrastructure Course
  • 36.
    Infrastructure and ProjectsAuthority Javier.Encinas1@ipa.gov.uk 40 | Infrastructureand Projects Authority Sustainable Infrastructure Course
