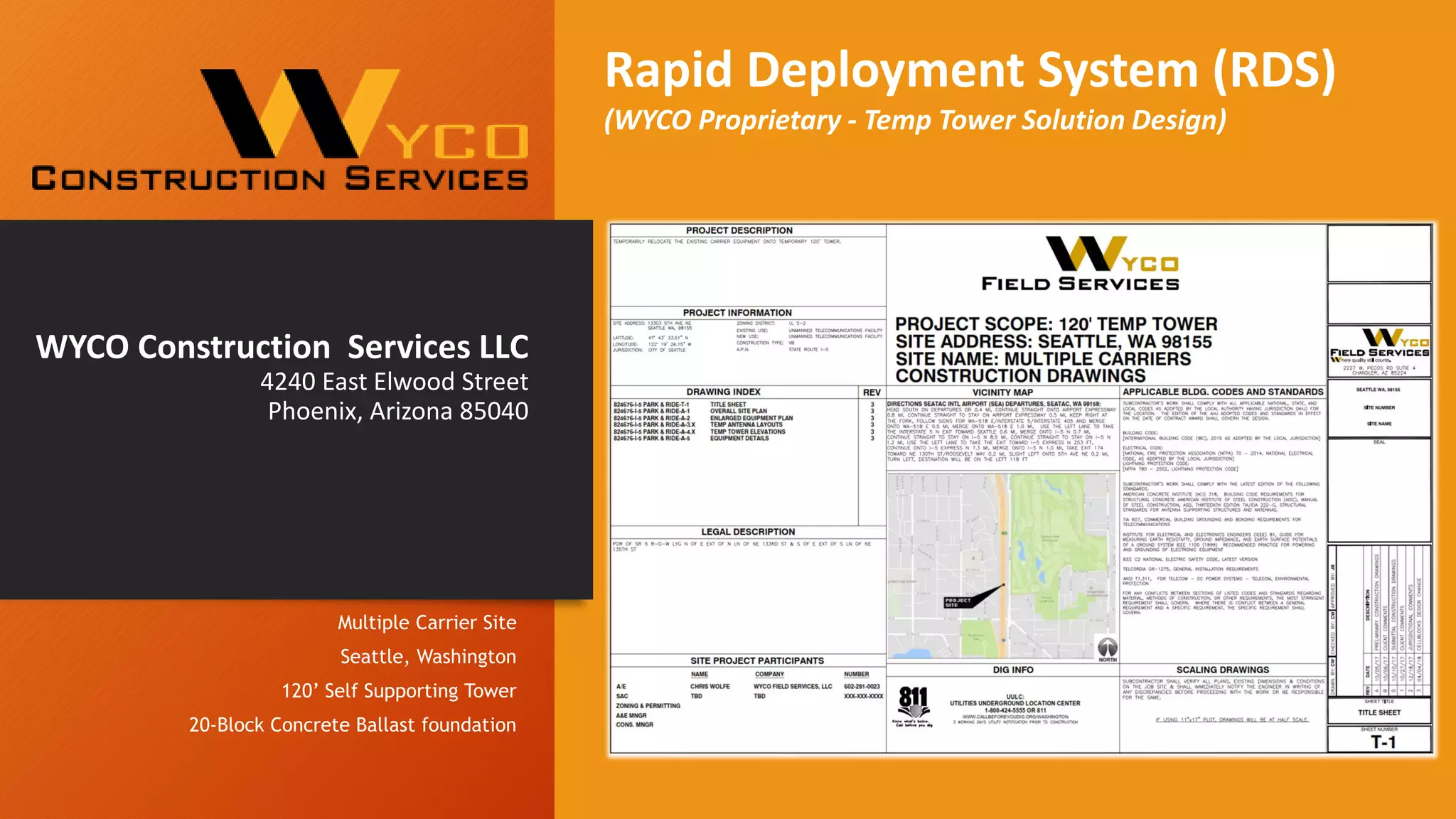

WYCO Construction Services LLC
4240 East Elwood Street
Phoenix, Arizona 85040
Multiple Carrier Site
Seattle, Washington
120’ Self Supporting Tower
20-Block Concrete Ballast foundation
Rapid Deployment System (RDS)
(WYCO Proprietary - Temp Tower Solution Design)
Highlights
• Existing failing structure requires a tower modification for additional capacity needs & 20’ tower-
extension.
• (4) wireless carriers required temporary displacement of equipment along one of Seattle’s busiest
highways.
• Carriers were able to achieve full network deployment of new RFDS with this robust tower design
assisting in better and faster coverage for residents while the existing structure was modified
• Jurisdiction would only approve one temp structure making this a very challenging deployment
• Project location is a critical cellular coverage area, all carriers needed to remain on air during
what was estimated as a 60-day project duration.
• Wyco Field Services & Client design collaboration
• No ground disturbance and no restoration post decomm
• Rapid deployment (total of three days from start to finish in the construction phase
Tower & Foundation Data
• Wyco Field Services, project specific foundation &
structural analysis completed and approved with CD’s
through jurisdiction
• Monopole, stealth & self-support structure options can be
utilized
• Loading supports configurations of multiple carriers to
200’+
• Concrete ballast block foundation; multi-use ballast blocks
designed for continued use & transport
• Minimal real estate footprint for compact lease areas in
many cases
• Material & equipment inventory managed by Wyco Field
Services as a value-added service
Portable Tower Site Lease Area

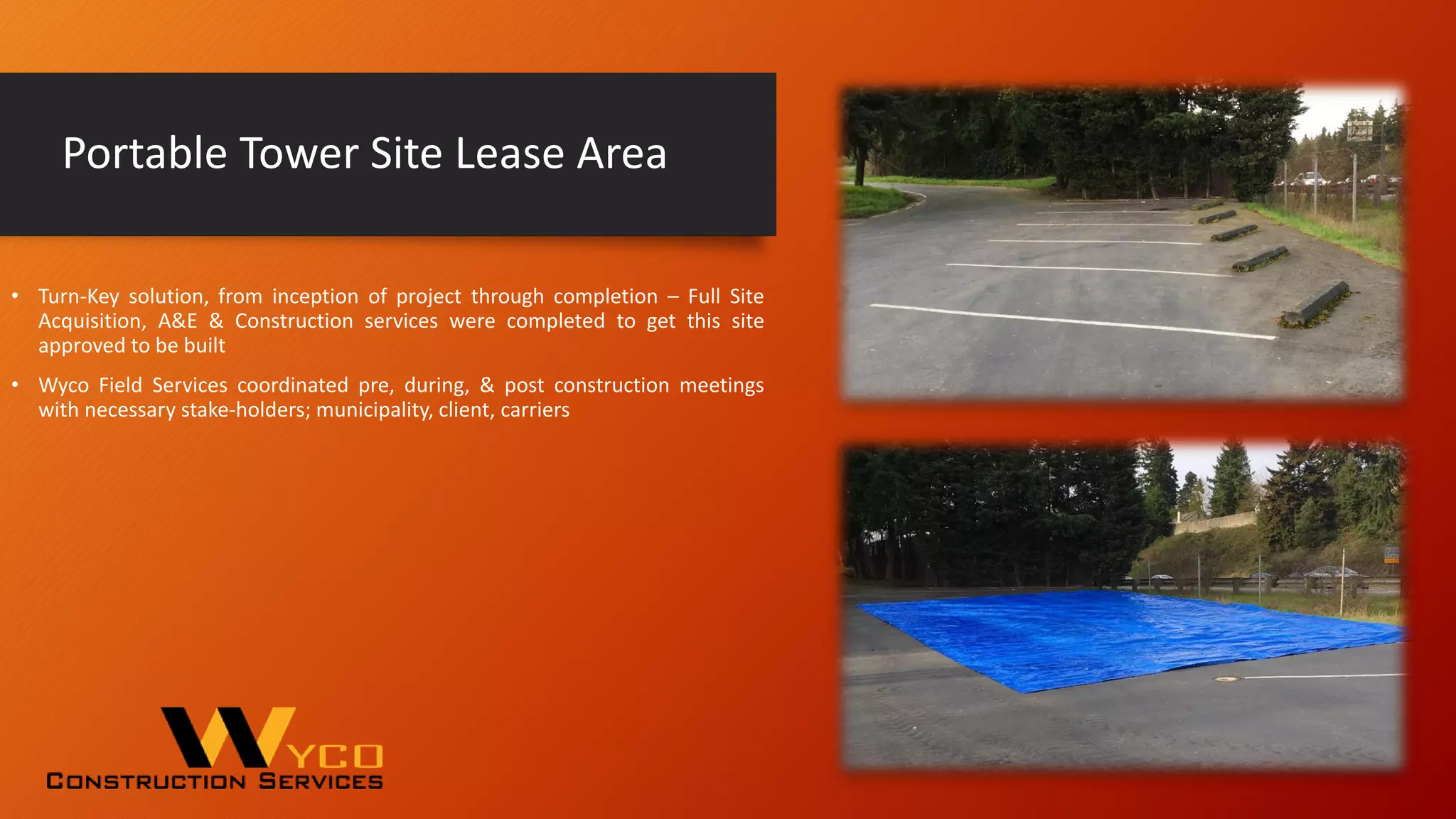

• Turn-Key solution, from inception of project through completion – Full Site
Acquisition, A&E & Construction services were completed to get this site
approved to be built
• Wyco Field Services coordinated pre, during, & post construction meetings
with necessary stake-holders; municipality, client, carriers
Foundation Base Material

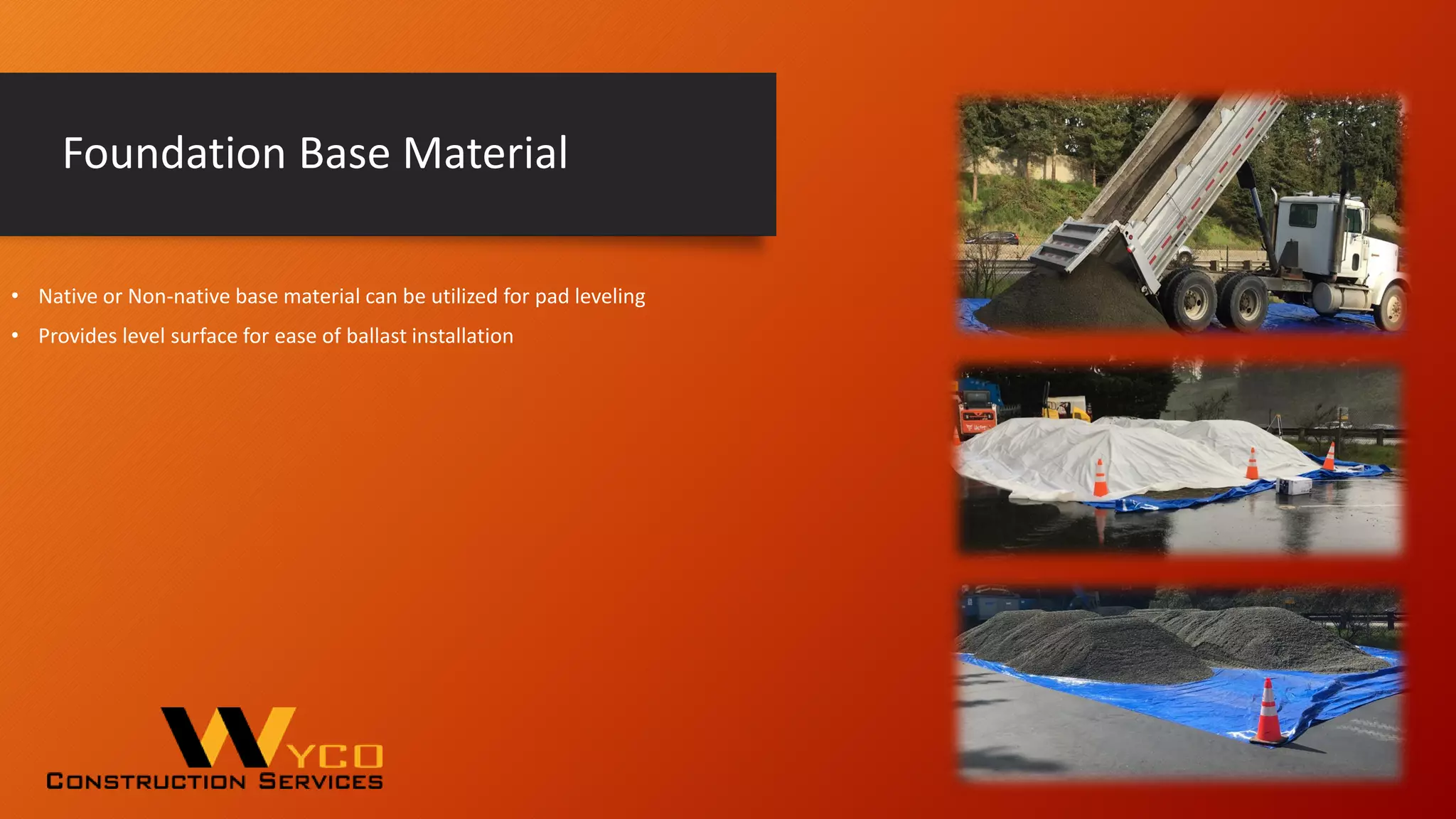

• Native or Non-native base material can be utilized for pad leveling
• Provides level surface for ease of ballast installation
Ballast Block Installation

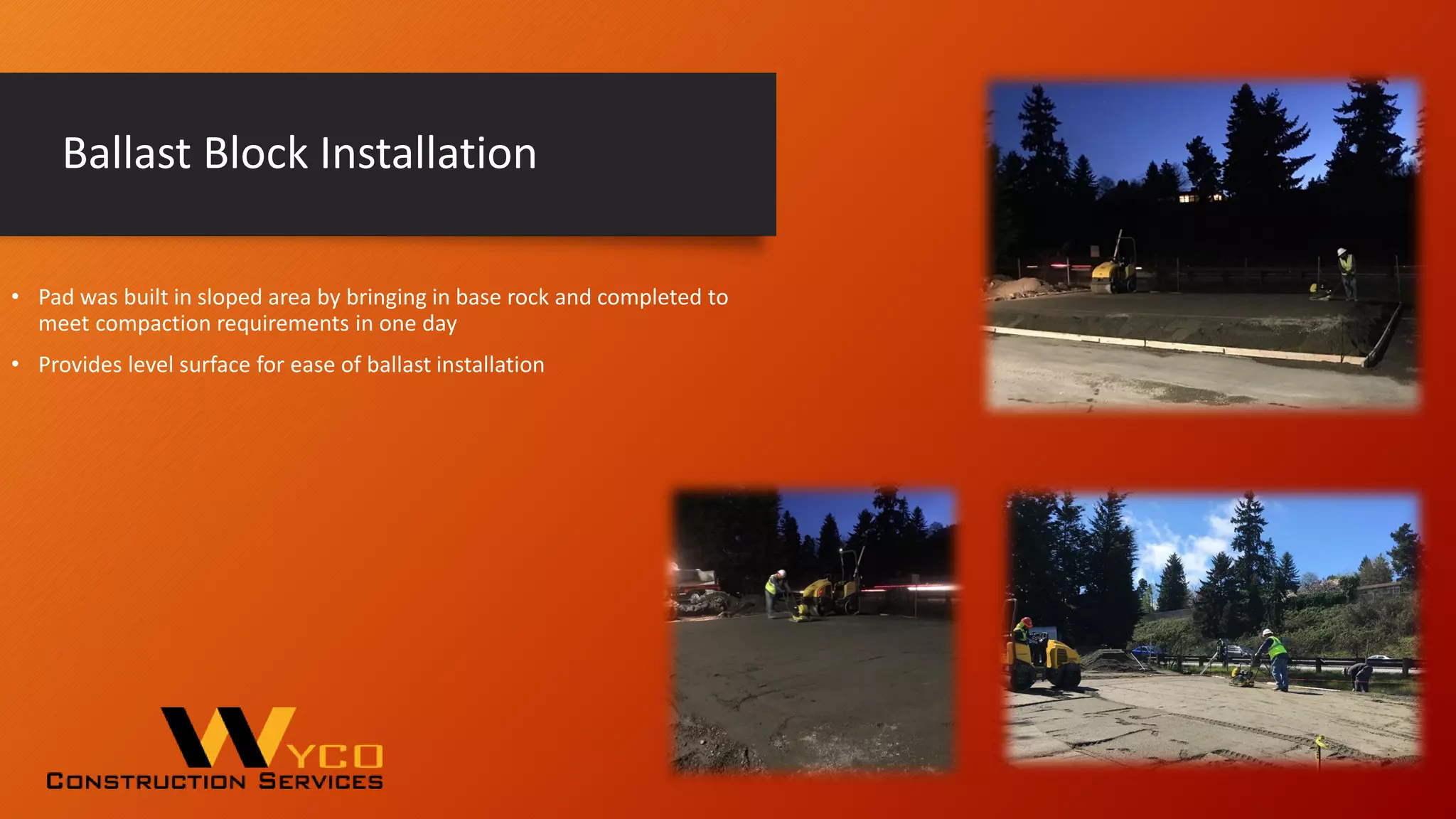

• Pad was built in sloped area by bringing in base rock and completed to
meet compaction requirements in one day
• Provides level surface for ease of ballast installation
Ballast Block Installation
• Keyed ballast for ease of installation & securement
• Site area must be level, sand/gravel base is used as top layer to achieve
desired foundation grade and compaction requirements
Ballast Block Installation
• Use of hydraulic ram to tighten & secure ballast blocks
• 1.25” diameter tension rods are used to fasten ballast blocks by way of
hydraulic ram-jack
Ballast Block Installation

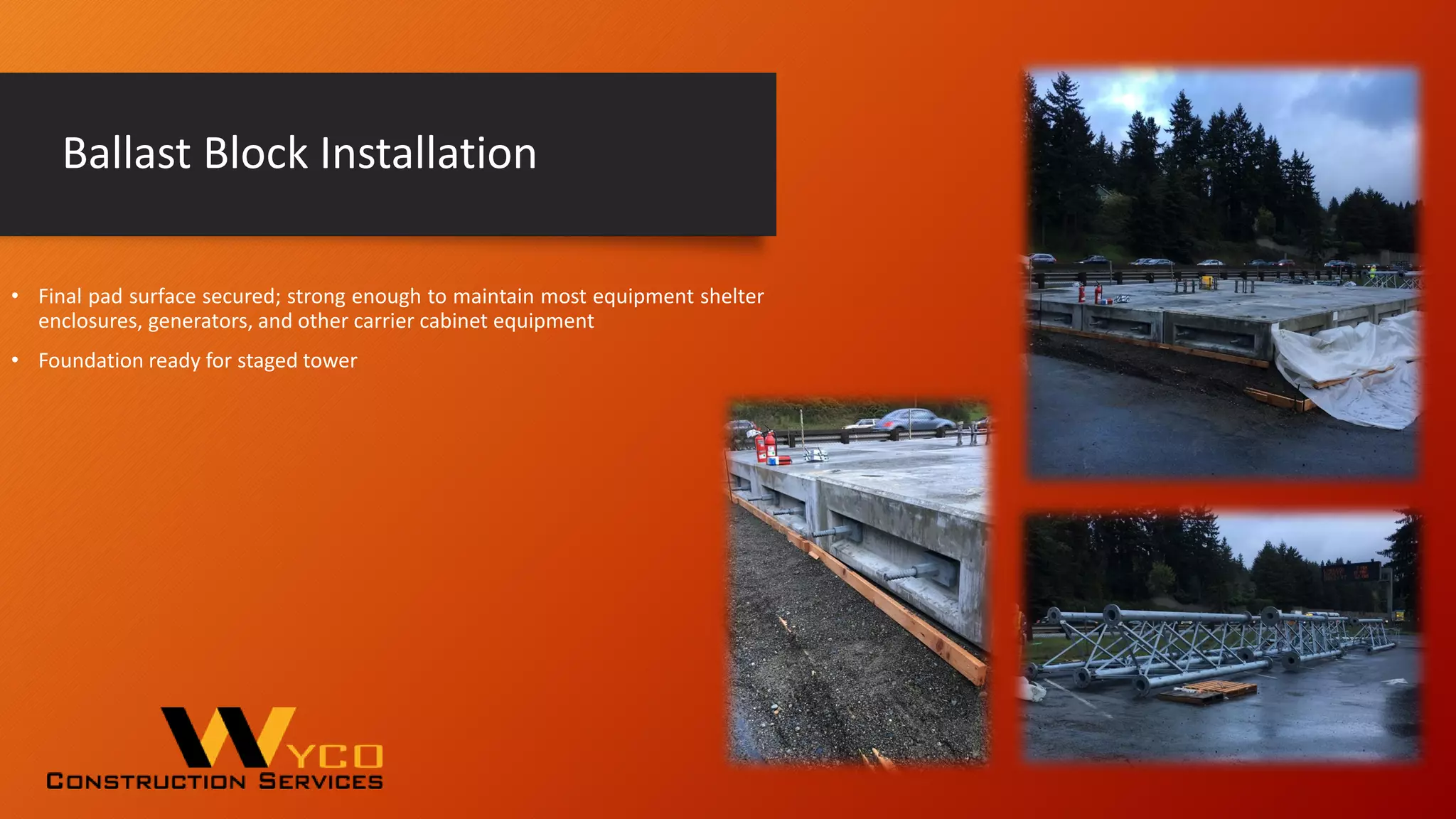

• Final pad surface secured; strong enough to maintain most equipment shelter
enclosures, generators, and other carrier cabinet equipment
• Foundation ready for staged tower
Tower Installation
• Tower or pole Installation
• Next Steps; configuration of carrier equipment to be placed on new structure
Tower Installation Complete
• Total build time on this project from start to finish, was three days.
• After removal once the structural MOD is complete on existing tower, this site
will be removed and relocated to a new project (Multiple Use)
• Upon removal of this temp structure, the site will go back to original condition
after cleanup, requiring no restoration saving money at the decomm phase
