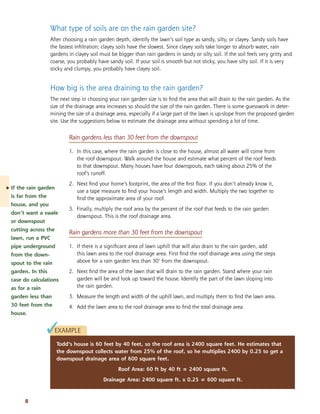

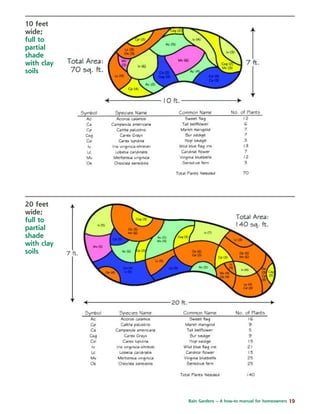

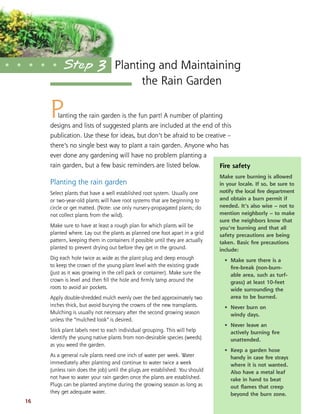

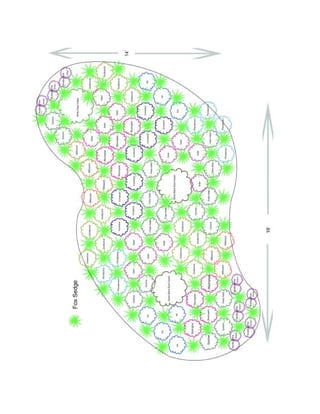

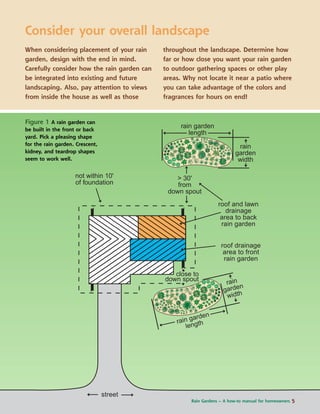

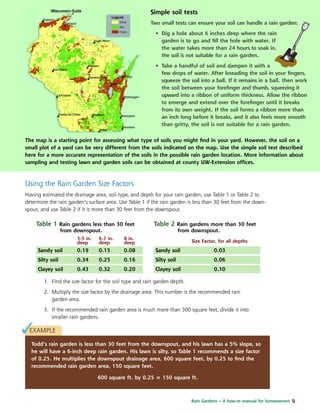

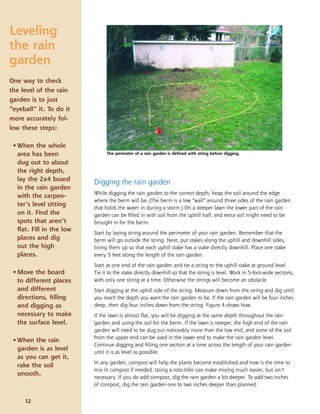

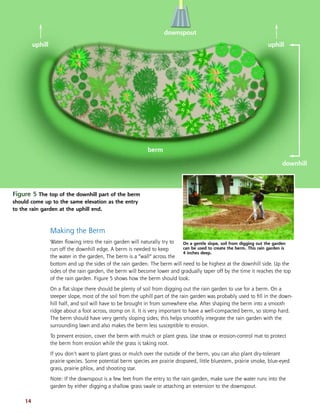

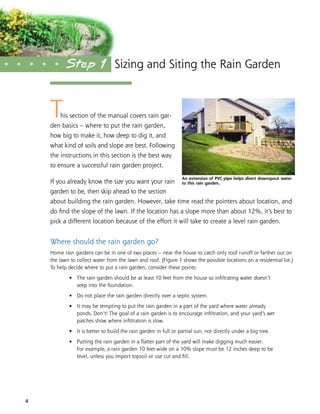

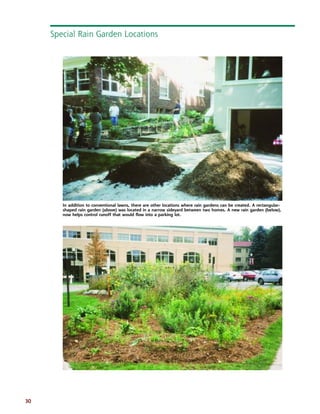

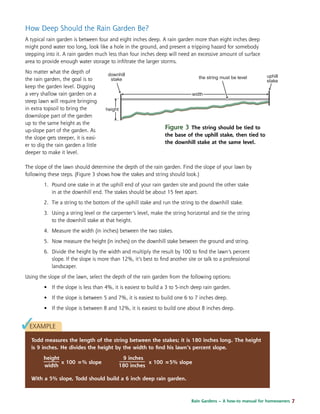

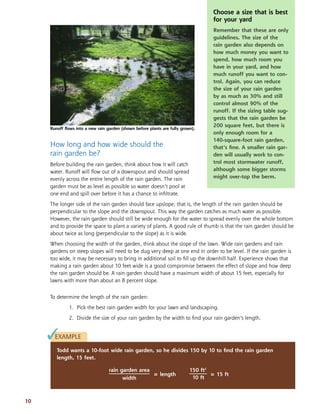

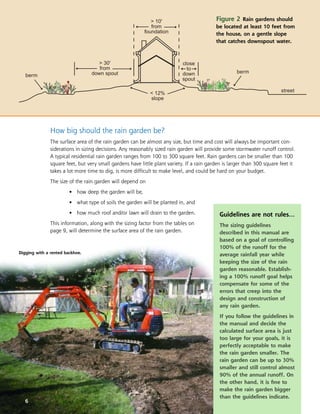

This document provides instructions for homeowners on how to design and construct a rain garden. It recommends siting rain gardens at least 10 feet from foundations and 30 feet from downspouts, in partial sun. The size should be 100-300 square feet based on roof/lawn drainage area and soil type. Depth depends on slope, ranging from 3-5 inches for slopes under 4% to 6-8 inches for steeper slopes. Proper siting and sizing helps rain gardens effectively absorb 30% more runoff than lawns.
