A

                       SUMMER TRAINING

                                 &

                        PROJECT REPORT

                                ON
          “HUMAN RESOURCE AUDITING ”
                               FOR

            AARTI INDUSTRIES LIMITED

      In the partial fulfillment of the requirement for M.B.A
                              (Full Time)

                          Submitted By

                  SHARMA PRAGATI SUSHIL
                      (M.B.A.) DIV A
                       ROLL NO 50

                          Submitted To

          PROF. JAYSHRI TAYLOR (Internal Guide)
            MR. KIRIT SASHTRI (External Guide)

G.I.D.C. RAJJU SHROFF ROFEL INSTITUTE OF MANAGEMENT
                   STUDIES, GRIMS, Vapi

                   AFFILIATED WITH
     VEER NARMADA SOUTH GUJARAT UNIVERSITY, SURAT
                ACADEMIC YEAR 2007-08
AARTI INDUSTRIES LIMITED

                      DECLARATION
 I, SHARMA PRAGATI SUSHIL hereby declare that the report on summer
 training and project work entitled “HUMAN RESOURCE AUDITING”
 submitted to ‘GIDC Rajju Shroff Rofel Institute of Management Studies” is a
 result of my own work and my gratitude to other work publications if any, have
 been duly acknowledged.

 PLACE: VAPI
 DATE:                                                SHARMA PRAGATI

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                 ACKNOWLEDGEMENT
     “Turning aspirations into realities is easier when quality people are support of
 ones efforts”

     I greatly concede the help provided by the company and the people working for
 providing the much valuable information and also extend my thanks for the support
 throughout the project report.

     I am also thankful and acknowledge my depth gratitude to my teachers and the
 director of GRIMS Dr. S.S.SHAH for his constant encouragement and direction in the
 completion of this project report. I am obliged to him and express gratitude to him
 for giving me a great opportunity for the preparation of the project report.

     I would like to express my heartful of gratefulness to Mr. Kirit Shastri for having
 given me this opportunity to do a project in this esteemed organization.

     I am also thankful and concede my depth of gratitude to my professor guide
 Mrs Jayshri Taylor for her constant encouragement and supervision in the
 completion of this training and the project.

                                                                PRAGATI SHARMA

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                            CERTIFICATE

This is to certify that Ms. PRAGATI SHARMA has satisfactorily completed the work
entitled, “SUMMER TRAINING PROJECT” specialization topic “HUMAN RESOURCE
AUDITING”. Based on the declaration made by the candidate and my association as a
guide for carrying out this work, I recommended this project report for evaluation as a
part of the MBA Programme of Veer Narmad South Gujarat University.

Date: 09/08/2007

Place: Vapi                                 ___________________
                                        (Guided By: JAYSHRI TAYLOR)

                                            __________________
                                                 (Director)
                                                 Dr. R. S. shah

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                 EXECUTIVE SUMMARY
     The summer training report contains the detail of employees of AIL about their
 living status and other problem faced by there in there day to day life.

     Than what is CSR a small idea about that by theoretical as well as from
 companies point of view.
     The report starts with introduction of the Indian Chemical Industry with the
 history of the AARTI INDUSTRIES LIMITES. The goals, mission and vision are also
 added.

     Than what is CSR a small idea about that by theoretical as well as from
 companies point of view.

     The finance department is covered every necessary information. The marketing
 department of the company was in Mumbai so we were not able to get complete
 information about the marketing department of the company.

     The production department has in it all the production details with the
 production process and the ETP plant which is situated in the company and owned
 by the company.

     The specialization project undertaken was in accordance to the Human
 Resource Department of the organization to know the working of the department in
 organization.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

     The Human Resource Auditing was basically done to know the working,
 systems policies and the procedures that are prevailing in the department of the
 organization.

     The methodology adopted for the completion of the project was to approach
 the Human Resource manager with a set of questionnaire.

     The data gathered shows that the AARTI INDUSTRIES LIMITED is having a
 good human resource department.

     The report contains the introduction of the Auditing. What does Audit
 contains? Why should Auditing be conducted?

     The analysis is done with the help of the questions asked and the response
 from the Human Resource Manager of the AIL.

     Then the findings are being shown. Lastly the suggestions are given to the
 company after the interpretation of the response of the Human Resource Manager.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                                  INDEX
                         PART 1 (ALL DEPARTMENT)

    SR. NO                         TOPIC                PAGE NO

      1      THE STRUCTURE OF THE CHEMICAL                1-2
             INDUSTRY

      2      AARTI INDUSTRIES LIMITED                     3-15
                CORPORATE INFORMATION                     3-5
                INTRODUCTION                             6-10
                THE COMPETITIVE ADVANTAGE OF              11
                 AARTI INDUSTREIS LIMITED

      3      HUMAN RESOURCE DEPARTMENT                   16-60
                RECRUITMENT                             19-24

                    SELECTION                           25-27

                    PROMOTION AND TRANSFER              28-30

                    TRAINING AND DEVELOPMENT            31-32

                    REMUNERATION                        33-38

                    PERFORMANCE APPRAISAL               42-45

                    MEDICLAIM POLICY                    48-49

                    SOCIAL RESPONSIBILITY               50-60

                     o    (CSR)                          56-60

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

      4      FINANCE DEPARTMENT                         61-81
                 INTRODUCTION                          61-64

                    STRUCTURE OF FINANCE DEPARTMENT     65

                    BALANCE SHEET                       70

                    PROFIT & LOSS A/C                   71

                    RATIO ANALYSIS                     72-76

                    SHAREHOLDING PATTERN               77-78

                    CHARTS                             79-81

      5      MARKETING DEPARTMENT                       82-122
                INTRODUCTION                            82-86

                    STRUCTURE OF MARKETING              87
                     DEPARTMENT
                    THE HOLISTIC MARKETING APPROACH     88-90
    SR. NO                        TOPIC                PAGE NO

                   THE MARKETING MIX                   94-114
                   o PRODUCT                            95-103
                   o PRICE                             104-107
                   o PLACE                             108-113
                   o PROMOTION                           114
                  PACKAING, LABELLING, WARRANTIES     115-120
                    AND GUARANTEES.
                  THE DISTRIBUTION CHANNEL              121
                  MODE OF TRANSPORTATION                122

       6     DESPATCH DEPARTMENT                       123-125

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

       7    PRODUCTION DEPARTMENT                   126-
               INTRODUCTION                      126-127
               PLANT LAYOUT                      128-129
               PRODUCTION PROCESS                130-133
               PRODUCTS                          134-142
               QUALITY CONTROL                   143-147

       8    RESEARCH & DEVELOPMENT DEPARTMENT     148-149

       9    STORES DEPARTMENT                      150

      10    PLANT UTILITY DEPARTMENT              151-153

      11    HEALTH AND SAFETY                     154-156
               AARTI HEALTH CARE                 155-156
               SAFETY DEPARTMENT                 157-165
               SHE POLICY                        166-168

      12    PROCESS OF HANDLING HAZARIOUS CHEMS   169-170

      13    MAINTENANCE DEPARTMENT                171-172

      14    EFFLUENT TREATMENT PLANT              173-177

      15    SWOT ANALYSIS                         178-179

      16    ANNEXURE

      17    BIBLIOGRAPHY

                       AARTI
PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

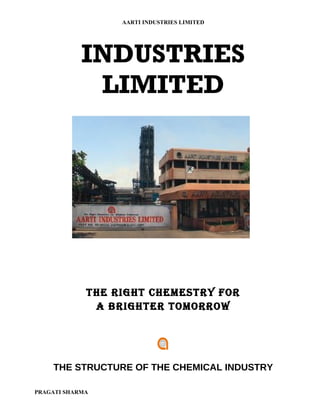

            INDUSTRIES
             LIMITED

             THE RIGHT CHEMESTRY FOR
              A BRIGHTER TOMORROW

    THE STRUCTURE OF THE CHEMICAL INDUSTRY

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

      In tune with the fast changing economic environment in the country, the Indian
 chemical industry too is on a steady growth path. Indian chemical industries has a
 strong and diversified base encompassing many areas such as organic and
 inorganic chemicals, plastic, fibers, dye stuffs, paints, pesticides, insecticides,
 speciality chemicals, drugs and pharmaceuticals. The growth in this sector has
 constantly been increasing than the average growth rate of the manufacturing
 sector in India.

      The chemical industry is sometimes referred to as the "keystone" industry
 because of the way the rest of the manufacturing sector relies on chemicals.
 Chemicals are nearly a $1.5 trillion global enterprise, and the U.S. chemical industry
 is the world's largest producer. The chemical industry is also the second largest
 consumer of energy in manufacturing and spends over $5 billion annually on
 pollution abatement. Chemical industry has 21% of total energy consumption.

      The Indian economy is firmly on the path of the steady growth. Even during the
 last decade when the other countries were in the grip of the massive slowdown,
 India continued to enjoy a comfortable position. This recent spurt in the growth is
 propelled by radical reforms such as the removal of the restrictions on foreign
 investment and industrial delicensing. With substantial increase in the domestic
 Gross Domestic Product (GDP) rate; the growth is also translated into increasing
 the demand in the domestic sector in various chemicals. Simultaneously the
 chemicals sector also shows growth in export.

                 THE INDIAN CHEMICAL INDUSTRY SIZE US $ 28 BILLION

                                        Knowledge
                                            18%
                                                    Basic
                               Speciality           57%
                                 25%

           Chemical Industry is an important constituent of the Indian economy.
           Its size is estimated at around US $ 28 billion approx, which is equivalent
            to about 7% of India’s GDP.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

           In terms of volume, it is 12th largest in the world, and 3rd largest in Asia.
           Within India, it constitutes about 15% of manufacturing capacity and 20%
            of the Excise revenue to the Government of India.
           Chemical industry has weight age of about 13% in the index of industrial
            production.
           The global chemical industry is valued at about US $ 1.7 trillion. Of
            which, India’s chemical sector accounts for just 2%.

     {The Indian chemical industry is the 12th largest in the World and 3rd largest in
 Asia. The Indian chemical industry constitutes 12.5% of the country’s industrial
 production and 15%of the manufacturing capacity of India. Also the chemical
 industry constitutes 6.7% to India’s GDP.}

  India’s Chemical Industry Export

           India’s chemical exports have recorded growth rate of 9%.
           For the year 2001-02, the chemical industry accounted for more than
            16.20% of the total Indian exports.
           For the year 2001-2002 exports of all chemicals and allied products were
            US $ 4684 million.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                  CORPORATE INFORMATION

  ∗ Name of the Company :
    AARTI INDUSTRIES LIMITED

  ∗ Type of Company:
    Public Limited

  ∗ Established Year :
    1984

  ∗ Size of Company:
    Large Scale

  ∗ Plants :

         Plot no. 801,801/23,
          802,803/1-2-3, GIDC,
          Phase 3, Vapi-396195

         Plot no. 902, GIDC ESTATE,
          PHASE 2, VAPI-396195,
          DIST: VALSAD, GUJARAT.

         Plot no. 752-753-754
          SARIGAM, TAL: UMARGOAN,
          DIST: VALSAD, GUJARAT

         Plot no.758/1, 758/2,
          GIDC ESTATE JHAGADIA,
          DIST: BHARUCH, GUJARAT

         Plot no. K-18, MIDC,
          TARAPUR,
          DIST: THANE, MAHARASHTRA.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

          Plot no. E-50, MIDC,
           TARAPUR,
           DIST: THANE,

  ∗   REGISTERED OFFICE: Plot no.801, 801/23
                         GIDC ESTATE, PHASE-3,
                         VAPI-396195, VALSAD

  ∗ CORPORATE OFFICE : Udyog Kshetra,
                       2nd floor, L.B.S.Marg,
                       Mulund-Goregaon Link Road,
                       Mulund (W), Mumbai-400 080

  Man-Power Force

  ∗ Board of Directors
    Chandrakant V. Gogri          Chairman
    Rajendra V. Gogri             Vice-Chairman & Managing Director
    Shantilal T. Shah             Vice-Chairman

  ∗ Independent Directors :
    Ramdas M. Gandhi
    Laxmichand K. Jain
    Vijay H. Patil
    Haresh K. Chheda

  ∗ Whole-time Directors :
    Parimal H. Desai
    Manoj M. Chheda
    Rashesh C.Gogri
    Hetal Gogri Gala
    Kirit R. Mehta

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

  ∗ Company Secretary
    Mohan P. Sonar

  ∗ Auditors
    M/s. Parikh Joshi & Kothare,
    49/2341, M.H.B.Colony,
    Gandhi Nagar, Bandra (East), Mumbai-400 051

  ∗ Registar & Transfer Agent :

              Sharpro Services (India) Pvt.Ltd.,
               Satam Estate, 3rd floor, above Bank of Baroda,
               Cardinal Gracious Road, Chakala,
               Andheri (E), Mumbai-400 099

  ∗   Bankers:

                Bank of Baroda
                Union Bank of India
                State Bank of India
                ABN Amro Bank
                Standard Chartered Bank
                HDFC Bank Ltd.
                Export-Import Bank of India
                IDBI Bank Ltd.
                City Bank N.A.
                UTI Bank Ltd.
                ICICI BANK LTD

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                       AARTI INDUSTRIES LIMITED

      In the business world, the only constant is change. Paradigms are remodelled,
 visions and business strategies modified, and technologies upgraded in response
 to the needs and challenges of a changing world. In other words, organizations have
 to   change   to     survive,    to   remain    competitive   and   to   succeed.   AARTI
 INDUSTRIES           LIMITED          (AIL)    is a dynamic organization, continuously
 investing in innovative products and processes, as well as cleaner technologies, to
 meet shareholder aspirations and societal expectations.

      AARTI was started in the year 1984. The first unit of AARTI group,
 ALCHEMIE LABORATORIES, commenced commercial production of DIMETHYL
 SULPHATE (DMS) in the year 1975. Today, AARTI has acquired world-class
 expertise in the development and manufacturing of basic bulk chemicals, dyes &
 pigment    intermediates,       pharmaceuticals     &   agrochemicals    along   with   their
 intermediates, rubber chemicals, surfactant intermediates and speciality chemicals.
 AARTI is amongst the largest producers of Benzene based basic and intermediate
 chemicals in India

      At AIL, they believe that the pursuit of corporate goals and commitment to
 social responsibilities have to go hand in hand. So, while the AIL are one of the
 largest producers of benzene-based intermediates in India and are ranked among
 the top five producers in the world, the AIL is also an organization alive to their
 responsibilities as a good corporate citizen. The people at AIL believe that high
 standards of business conduct are integral to earning the trust and respect of
 stakeholders and therefore have zero tolerance towards unethical behaviour or
 corruption in any of their business dealings.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

     AIL is a multi-product, multi-location company manufacturing over 125
 products at global-scale. AARTI has manufacturing sites at Gujarat, India (Vapi,
 Sarigam & Jhagadia) and at Maharashtra, India (Tarapur & Dombivli). The Tarapur
 facility of AIL’s API division.

     AARTI has attained a total turnover of US $ 189 million in the year April 2003-
 March 2004 with flagship companies AARTI INDUSTRIES LIMITED (AIL) &
 AARTI DRUGS LIMITED (ADL) listed on Stock Exchanges. AARTI has a
 Subsidiary AARTI HEALTHCARE LIMITED (AHCL), which is engaged in
 manufacturing of Active pharma ingredients ranging from Ace Inhibitors,
 Broncodialators to Steroids.Recognizing the importance of research, AARTI has
 established three full-fledged DSIR (Dept. of Scientific & Industrial Research)-
 Government of India recognized R & D centers, which carry innovative product and
 process development work.

     AARTI INDUSTRIES LTD. is an ISO 9002/GMP certified organization and a
 flagship company of the USD 259 million strong Aarti Group. AARTI has the
 privilege of catering to the requirements of leading manufacturers of dyes,
 pigments, pharmaceuticals, agrochemicals and rubber chemicals in countries such
 as USA, UK, Germany, Spain, Italy, Switzerland, Belgium, Japan, Korea, China,
 Russia, etc. AARTI also has representatives in USA & a subsidiary company in UK
 to provide better services to its Export Customer.

     For the people at AIL, sustainable growth is not an end-point, but an ongoing
 process and a life-time commitment. The dedication of AARTI INDUSTRIES
 LIMITED to the principles of sustainability is best encapsulated in their
 company's motto - "The right chemistry for a better tomorrow". A better tomorrow
 for our children and future generation.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

     AIL will always be a socially responsible company. The company AIL always
 value the active involvement of their people their mission of achieving sustainable
 growth. The company also thanks all of their shareholders, customers, business
 partners, as also the media, financial institutions, industrial associations, NGOs,
 government organizations, neighbouring industries and local communities for
 placing their trust in the company i.e. The AARTI INDUSTRIES LIMITED and
 being a part of this exciting journey of sustainable growth. At AIL, a sharp focus on
 the three main constituents of the "Triple Bottom Line"- economy, society, and
 environment – guides their activities towards greater sustainability. AARTI
 INDUSTRIES commitment to corporate social responsibility is corroborated by
 the company’s emphasis on creating a performance-based ambience for their
 people, their respect for human rights and labour welfare, their commitment to high
 ethical standards, their initiatives in the areas of health, education and environment
 preservation, and their endeavors to create value for the company’s stakeholders.

     Over the last two decades, we have acquired world-class expertise in the
 development and manufacturing of basic bulk chemicals, dyes & pigment
 intermediates, pharmaceuticals & agrochemicals along with their intermediates,
 rubber chemicals, surfactant intermediates and speciality chemicals. AIL’s API
 division, Aarti Healthcare, makes high-value lifestyle APIs which are used in
 manufacturing cardiovascular, antiasthmatic, anti-cancer, anti-thalassaemic, anti-
 hypertensive and anti-depressant drugs Exports account for over 40% of our total
 sales. At present, AIL export to more than 40 countries worldwide including USA,
 UK, Germany, Spain, Italy, Switzerland, Belgium, Japan, Korea, China and Russia.
 Over 60% of AIL’s exports are to developed countries, with more than 40% going
 to the EU.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                                      GOALS
     AARTI group is strategically placed to exploit growth opportunities in the
 Chemical Industry. In view of its technical expertise and broad base satisfied
 clientele in India and abroad, AARTI is looking for global partners and strategic
 alliances in areas of mutual interest viz.

       o   Development of International markets for AARTI's products.
       o   Toll manufacturing.
       o   Transfer of Technology / Technical know-how.

                          VISION STATEMENT
     We will be a world-class organization that enhanced value to our customers
 and other shareholders by

       o   Caring for employee to work as motivated terms in open and learning
           environment.
       o   Setting challenge new standards of performance.
       o   Focusing on total quality, innovation and responsible care towards the
           environment.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                        MISSION STATEMENT
     We are in the problem of manufacture and supply of crop production and

 specialty chemicals worldwide providing solutions to optimize farm productivity for

 the Indian farmer through out innovate and cost effective product to provide the

 customer, better value of money.

       ♦   Exceed the expectations of our valuable customer for quality of products

           and services.

       ♦   Strive to make continuous important and bring excellence in productivity,

           safety, environment and hygiene in all the area of operation.

       ♦   Emphasize on appropriate training to all the employees and be open to all

           their suggestions through team participation.

       ♦   Strive to make AARTI INDUSTRIES LIMITED of a world-class

           organization.

THE COMPETITIVE ADVANTAGE OF AARTI INDUSTREIS
                   LIMITED

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

        •   The AARTI INDUSTRIES LIMITED (AIL) considers that their R&D

            is quite good which helps the industry in gaining the advantage

            compared to their competitors.

        •   The people in the AIL’s R&D department keep on doing the research

            work continuously which helps them in gaining more advantage than that

            of their competitors i.e. reduction of the cost or increasing the quality of

            the product that are to be served to theirs customers.

      POSITION OF AARTI INDUSTRIES LIMITED (AIL)

     The manufacturing units of the AIL are of global scale and are mostly in the

 States of Gujarat and Maharashtra. Both the units are ISO / GMP certified. The plants

 are highly incorporated along with Cost-Efficient Manufacturing Process and Low

 capital investment and manufacturing more than 100 products. The AARTI

 INDUSTRIES LIMITED is ranked amongst top 5 Global manufacturers for their

 key product and their continuous R&D support and process improvement is the key

 for Company to remain competitive globally.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

       SOME KEY FACTS ABOUT AIL

   •   AARTI INDUSTRIES LIMITED is one of the largest producers of

       benzene-based basic and intermediate chemicals in India and among the top

       five globally.

   •   AARTI INDUSTRIES LIMITED one of the top three producers of

       Dimethyl Sulphate in the world.

   •   The AARTI INDUSTRIES LIMITED has a fully backward integrated plant

       for Dimethyl Sulphate, i.e., starting from Sulphur and Methanol.

   •   AIL    Rs.500    crore     company   manufacturing   Organic   chemical   and

       Intermediates for Vapi unit.

   •   AIL derives about 90 per cent of its revenues from specialty and basic

       chemicals.

   •   Through its backward integration manufacturing, AARTI INDUSTRIES

       LIMITED acquires the competitive advantage with respect to the availability

       of raw materials and reduced cost.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

   •   AIL has the largest installed capacity of chloro-benzene (ONBC and PNBC)

       domestically.

   •   The company is adding more fluorine based products in its portfolio.

   •   The company has in recent times been focusing on specialty chemicals and

       pharmaceuticals.

   •   AARTI INDUSTRIES LIMITED doubled its sales turnover in the last

       four years from Rs 345 crores in 2001-2002 to Rs 786 crores in 2005-2006

       whereas exports increased more than three times during that period from Rs

       101 crores in 2001-2002 to Rs 342 crores in 2005-2006.

   •   AARTI INDUSTRIES LIMITED carries out custom synthesis activities

       and undertakes contract research & manufacturing.

   •   AARTI INDUSTRIES LIMITED was been presented the star exporter

       award for 2004-05 by "The Gujarat Dyestuffs Manufacturers' Association" for

       earning the highest foreign exchange from direct export of self-manufactured

       dyes & dyes intermediates. This was one of a biggest reward to the AARTI

       INDUSTRIES LIMITED for their efficient effort.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                  General Rules and Regulation

     These are the rules and regulations that the employees of AARTI
 INDUSTRIES LIMITED have to pursue stringently and the employees do follow
 all these rules and regulations happily for the betterment of their lives as well as the
 company.

       ♦ The Employees cannot bring any kind of unnecessary resources like
          matchboxes or cigarette, alcohol, tobacco, etc.
       ♦ The employee after entering the premises of the AIL should always put on
          his identity card with him.
       ♦ During functioning hours the employees should not meander any where,
          devoid of their work and wasting the time.
       ♦ While entering and departing out of the AARTI’s premises each and
          every employee should make an entry by means of purchasing card from
          the security office at the main gate of the AIL.
       ♦ Any employee of AIL should not remain missing or absent without former
          informing to his department head and P & A. Dept. unless and until the
          explanation of absent is bad health or any urgency that might have
          occurred.
       ♦ Every employee should be dressed in uniform that has been provided to
          them by the company while entering the premises of the AIL with the
          safety shoes, apron and safety helmet as per pre instructed to them.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

   Company’s shared value:
       o Global capacities
       o Customer Satisfaction
       o Quality and logistics
       o Continuous cost control
       o High value addiction
       o Diversified product range
       o Loyal work force
       o In-house recognized R & D Centers.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

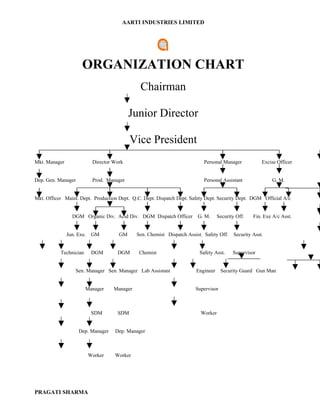

                      ORGANIZATION CHART
                                                Chairman

                                            Junior Director

                                            Vice President
Mkt. Manager                Director Work                                    Personal Manager           Excise Officer

Dep. Gen. Manager           Prod. Manager                                    Personal Assistant             G. M.

Mkt. Officer Maint. Dept. Production Dept. Q.C. Dept. Dispatch Dept. Safety Dept. Security Dept. DGM Official A/c

                 DGM Organic Div. Acid Div. DGM Dispatch Officer          G. M.     Security Off.   Fin. Exe A/c Asst.

               Jun. Exe.    GM         GM      Sen. Chemist Dispatch Assist. Safety Off.   Security Asst.

           Technician       DGM       DGM       Chemist                    Safety Asst.    Supervisor

                   Sen. Manager Sen. Manager Lab Assistant               Engineer     Security Guard Gun Man

                        Manager      Manager                             Supervisor

                            SDM       SDM                                  Worker

                    Dep. Manager     Dep. Manager

                           Worker    Worker

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

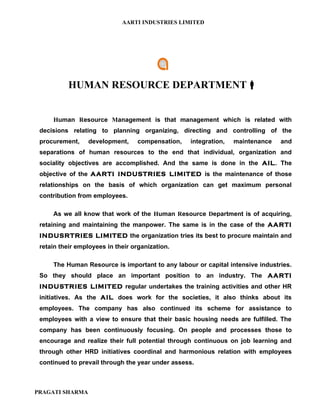

           HUMAN RESOURCE DEPARTMENT

     Human Resource Management is that management which is related with
 decisions relating to planning organizing, directing and controlling of the
 procurement,    development,     compensation,   integration,   maintenance   and
 separations of human resources to the end that individual, organization and
 sociality objectives are accomplished. And the same is done in the AIL. The
 objective of the AARTI INDUSTRIES LIMITED is the maintenance of those
 relationships on the basis of which organization can get maximum personal
 contribution from employees.

     As we all know that work of the Human Resource Department is of acquiring,
 retaining and maintaining the manpower. The same is in the case of the AARTI
 INDUSRTRIES LIMITED the organization tries its best to procure maintain and
 retain their employees in their organization.

     The Human Resource is important to any labour or capital intensive industries.
 So they should place an important position to an industry. The AARTI
 INDUSTRIES LIMITED regular undertakes the training activities and other HR
 initiatives. As the AIL does work for the societies, it also thinks about its
 employees. The company has also continued its scheme for assistance to
 employees with a view to ensure that their basic housing needs are fulfilled. The
 company has been continuously focusing. On people and processes those to
 encourage and realize their full potential through continuous on job learning and
 through other HRD initiatives coordinal and harmonious relation with employees
 continued to prevail through the year under assess.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

     As it is aptly said that Human Resource is an asset for any organization for the
 success of any organization human resource play a significant role. If any
 company’s Human Resource is not up to the mark or efficient then it affects the
 performance of an organization.

     Each and every department is linked with another department. One department
 forms a stair for the other department in the same way the Human Resource play a
 vital role in each and every department whether it is finance department, marketing
 department, production/operation department, R & D department or any other. The
 manpower must be efficiently employed to get an effective result.

  Functions of Human Resource Manager:

     The following are main function of human resource manger in AARTI
 INDUSTRIES LIMITED:

       ∗   Application and control of company rules and organization policy.

       ∗   Recruitment of manpower intended by HOD and approved by management

           and top head.

       ∗   Employee and trainees induction programmed arrangement.

       ∗   Development of trainees by training and approvals

       ∗   Transport arrangement for required by employees, guests & customer.

       ∗   Booking and reservation as required by employees / guests.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

      ∗   Safety of company material and employees.

      ∗   Maintenance of first aid material.

      ∗   Canteen administration

      ∗   Assistance of meeting and conference

      ∗   Company occasions arrangements like annual day, Picnic.

      ∗   Labor welfare activities as decided by management.

      ∗   Arrangement of uniform, shoes, seasonal wear, safety equipment.

      ∗   House keeping of company premises.

      ∗   Casual labor arrangement

      ∗   Building maintenance and office maintenance

      ∗   Public relation activities.

      ∗   Salary wages and perks administration works and recorded keeping.

      ∗   Telecom related activities

      ∗   Appraisal assistant of employee for increments , training, promotions

      ∗   Factory Act related activities

      ∗   Stationary planning and arrangement.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                              RECRUITMENT

      Recruitment in simple terms is searching for capable applicants for the job.

 Recruitment is attracting and obtaining the eligible candidates so that the right

 people are selected for the job.

      Recruiting of the individuals or the recruitment process is one of the most vital

 and complicated part of an organization. If any error is made in the recruitment

 process, then in a straight way it could be seen in the work performance of the

 employees and the profits of the company as a single mistake will have an effect on

 the result of the organization. As AARTI INDUSTRIES LIMITED is producing

 some of the hazardous chemical so for them man power recruitment process is

 hard-hitting job.

      Recruitment is the generating of the application of applicants for specific

 position through many of the sources from them the three common sources are the

 advertisement, state employee exchange agencies or a private employment.

      According to AARTI INDUSTRIES LIMITED they formulate a selection

 policy, due consideration is to be given to organizational requirement as well as

 technical and professional dimension of selection procedure adopted by AARTI

 INDUSTRIES LIMITED and that it is tailor made to meet its particular needs.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

 The thoroughness of the procedure depends upon three factors.

      Nature of selection.

      Policy of the company.

      The length of the probability period or trial period.

     The company has also continued their schemes for assistance to employees

 with a view to ensure that there basic housing needs are fulfilled. The company has

 been continuously focusing. So they should place an important position to

 industries. The AIL company regular undertakes the training activities and other

 Human Resource initiatives. The Human Resource is important not only to any labor

 intensive but to the capital intensive industries also. On people and processes

 those to encourage and realize their full potential through continuous on job

 learning and through other HRD initiative cordial and harmonious relation with

 employee continued to prevail through the year under review.

     Human Resource plays a vital role in each and every department whether it is

 finance department, marketing department, production/operation department, R&D

 department or any other. In an organization the manpower must be efficiently used

 to make out the best from them. Human Resource is asset for any organization for

 the success of any organization. Human Resource plays an important role. If any

 company’s Human Resource is not a standard or not efficient then it affects the

 performance of an organization.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

 Source of Recruitment :

    The sources that are used for the recruitment purpose in AARTI
 INDUSTRIES LIMITED are as follows:

  • Internal sources

    ∗   Transfer
    ∗   Promotion

  • External sources

    ∗   Advertisement
    ∗   Educational institution
    ∗   Labor contractors
    ∗   Recruitment agencies.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

             RECRUITMENT PROCEDURE:-
          NEWSPAPER
          APPLICATION

           RECEIVING
          APPLICATION

            SORTING
              OUT
          APPLICATION

                                                    WRITTEN TEST

           INTERVIEW

                                                     SORT TEST

            FINALIZE

                                                     INTERVIEW

          II INTERVIEW

                                                    OFFER LETTER

            OFFER
            LETTER
                                                     JOINING THE
                                                    ORGANIZATION
          JOINING THE
         ORGANIZATION
                                                    APPOINTMENT
                                                       LETTER
         APPOINTMENT
            LETTER

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                   THE RECRUITMENT PROCESS

     The process of recruitment can be explained as under:

 NEWSPAPER APPLICATION:

     Very firstly the AIL gives the advertisement in the newspaper so that the
 applicants are attracted towards the advertisement and they apply in the company
 for the required post. In that newspaper advertisement the AIL gives the required
 qualification for the post. So that the applicants who are that qualified and capable
 only they apply for the job.

 RECEIVING APPLICATION:

     After the advertisement placed in the newspapers the AIL receives the
 application forms of those candidates who are willing for the job.

 SORTING OUT APPLICATIONS:

     After the applications being received by the AIL, they do the work of sorting
 out the applications. A panel is selected and those people in the panel do the work
 of sorting the received applications and then according to those panel members the
 candidates who are capable to go a step further i.e. for the interview are being
 selecte.

      Before the interview the AIL goes for a test for the candidates which is a
 written test in which the candidates are given a questionnaire in which the AIL ask
 few questions which has to be answered in a written form. After the test the answers
 are gone through and then the candidates whose answers are found to be
 interesting are further being called out for the interview.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

 INTERVIEW:

     Then the interview is held. Some employees of the AIL from the executive level
 are being selected so that those people carry out the interview without any
 biasness. In the interview the employees of the AIL carries on with the question
 answer sessions. By this interview the panel gets a clear picture of which people are
 competent for the job and can go for the further process of the recruitment.

 FINALIZE:

     Finally the applicant who is found to be competent enough by the panel is
 being finalized after the finalization the employee is asked to go under a physical
 checkup under the doctors and submit the report in the AIL.

 OFFER OR APPOINTMENT LETTER:

     After all the procedures are completed and a clear chit given by the doctors the
 employees are being given an offer or an appointment letter to join the organization
 the candidate.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                 SELECTION PROCEDURE

                      APPLICATION
                         FORM

                       INTERVIEW

                        PHYSICAL
                      EXAMINATION

                       REFERENCE

                    FINAL APPROVAL

                      EMPLOYMENT

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                      THE SELECTION PROCESS
     The selection is the process of making a choice or deciding on individuals from
 among many. The selection process is of selecting a well deserving, capable and
 competent candidate for the given job. The selection can be from within the
 organization as well as fresh candidate. If the filling of the job is to be done
 internally or from within the organization then it can be done by the promotion and
 transfers of the employees but if the filling of the job is via externally then it can be
 done through the recruitment and the selection procedure of the organization.

 APPLICATION FORM:

      The application form is given to the candidates and that the candidates are
 asked to fill them. The AIL is very much careful while going on with the selection
 process. The AIL not only selects the people from the external source but also
 from the internal source.

  INTERVIEW:

     The AARTI INDUSTRIES LIMITED after the receiving of the application
 form from the candidates the company goes for the interview. In the interview the
 AARTI INDUSTRIES LIMITED top level management sees to it that the
 process is carried out very properly and that the candidates are selected on the
 basis of their experience, compatibility, competence, and qualifications. The AIL
 keeps in mind that the candidates selected are experienced and that this is the most
 important criteria the AIL look at before selecting any of the candidates for their
 company.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

 PHYSICAL EXAMINATION:

     The company after going on with the interview process some slot of candidates
 are selected and also that the selected candidates are being asked to go for the
 physical checkup as the physical checkup may help the AIL to know whether the
 candidates are completely healthy or not. The candidates are asked to submit a
 report of their fitness in the organization and then the further decisions are being
 taken by the organization. As the physical checkup may help the AIL to avoid
 future problems.

 REFERENCE CHECK:

     After the company carries out with the physical checkup of the selected
 employees, the company cross checks the reference. For a company reference
 check is one of the important criteria while selecting the candidate or while giving
 the employment to the applicant.

 FINAL APPROVAL:

     After the reference check is been completed the next step is to give approval to
 that candidate who has completely satisfied the AARTI INDUSTRIES LIMITED
 requirement of an employee.

 EMPLOYMENT:

     After the company has completed all their procedures now is the time to give
 the employment to the candidates who are selected by the organization for their
 company.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                 PROMOTION AND TRANSFER

  PROMOTION
     AARTI INDUSTRIES LIMITED gives progression to its employees with
 enhanced pay, position and employment responsibility all the way through
 encouragement by promoting them as per the responsibility and the work done by
 the employees as one of the best way of expressing the employees excellent work is
 by promotion or by increasing the employee’s remunerations.

  PROMOTION CRITERIA
     The AARTI INDUSTRIES LIMITED has a promotion policy that, the
 promotion to the employees is given on the basis of seniority. AARTI
 INDUSTRIES LIMITED has resolute to give promotion after every two years of
 the working period of the employees. If an employee is not satisfied of the post he
 has, the employee is then sent back to his position for the duration of his promotion
 period. As per their resolution the AIL gives promotion to its employees by the way
 of their seniority which is 40% and out of 60%, 20% by the way of personal interview
 and 40% by performance appraisal so that none of the employees feel that they are
 been deceived by the company authority and the well deserved employee is being
 given the promotion.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

  PROMOTION POLICY

     AARTI INDUSTRIES LIMITED has espoused the promotion policy as per
 the seniority as well as on the merit basis of the employees. The seniority of
 employee is regarded grade wise as per character residence period on the particular
 grade. Also the work done by the employees are given significance by the AIL.

  TRANSFERS

     As we all know that transfer is a cross shifting the employee as per the demand
 or a requirement of the employee, causing a movement of an employee from his/her
 one job, section, department shift, plant or position to another at some or another
 place with that particular departmental salary status and responsibility, etc.

     The Aarti Industries Limited follows a well define transfer policy to
 avoid any grievances among the employees.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

     • Periodic Transfer
     In the AARTI INDUSTRIES LIMITED periodic type of transfers is mainly
 for those departments whose regional areas and sales department are located
 abroad or out the country. For that reason the marketing department is the only
 department which has the periodic transfer present in it.

     The AARTI INDUSTRIES LIMITED has a policy according to that policy
 the marketing personals are transferred every four year, so they can come back to
 the native state. There are no frequent transfers that exist n the company and they
 are avoided in company as the AIL are being concerned of the adverse effects of
 transfer on heir employees which is seen in the work of the employees.

     • Internal Transfer
       The internal and the departmental transfer are mostly avoided in the AARTI
  INDUSTRIES LIMITED.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

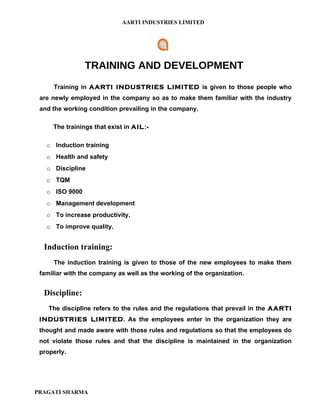

                TRAINING AND DEVELOPMENT
     Training in AARTI INDUSTRIES LIMITED is given to those people who
 are newly employed in the company so as to make them familiar with the industry
 and the working condition prevailing in the company.

     The trainings that exist in AIL:-

   o Induction training
   o Health and safety
   o Discipline
   o TQM
   o ISO 9000
   o Management development
   o To increase productivity.
   o To improve quality.

  Induction training:
     The induction training is given to those of the new employees to make them
 familiar with the company as well as the working of the organization.

  Discipline:
    The discipline refers to the rules and the regulations that prevail in the AARTI
 INDUSTRIES LIMITED. As the employees enter in the organization they are
 thought and made aware with those rules and regulations so that the employees do
 not violate those rules and that the discipline is maintained in the organization
 properly.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

  Health and safety:
      The health and safety of the employees is of the utmost importance for the
 company and for that purpose the AIL gives the employees the instruction for their
 safety and the compulsory usage of the things which are used for the safety
 purpose e.g. gumboots, caps etc. so that the accidents are avoided and health and
 safety of people are more concentrated by the organization. So for that reason the
 organization motivates the employees for the occupational health, safety and
 environment, safety policy, philosophy, accident prevention techniques, safety
 procedure etc.

      The safety department conducts in plant safety training program on regular
 basis.

  •   Chemical emergency, prevention preparedness and response.
  •   Importance and use of safety equipment (Explosive, oxygen, CL-2, HCN,
      Monitors, SCBA, ESA, Fire Gas Tight Suit, First Aid-Box)

  Total Quality Management: (improving quality)
      Total Quality Management (TQM). The quality being the most important part of
 the product and it’s selling so for that reason the employees are thought of the
 quality management so that they understand the actual and good quality products
 and they make a quality product. As the quality gives the clear picture of the
 organization the AIL also believes in giving the bet quality products to their
 employees.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                            REMUNERATION
     The remuneration that the AARTI INDUSTRIES LIMITED provides to
 each of the employees is as follows

        Salary:
        The Board of Directors is to be provided with the Salary of Rs.85, 000/- per
  month with power to make an annual increment area under discussion to a
  maximum amount of Rs.1, 50,000/-per month in respect of salary and privilege up
  to 100% of salary.

        Commission:
          In accumulation to the salary, the whole-time Directors of the AARTI
  INDUSTRIES LIMITED shall also be entitled to be paid share in comprehensive
  commission calculated at the rate of 1% of not profit of company computed under
  section 349 of the companies act, 1956 payable to all company share of such
  commission shall be payable after the annual accounts are adopted by the
  shareholders.

        Perquisites:
          Apart from the salary and commission regularly paid, the whole-time
  Director shall be permitted with the allowances:

          o House rent allowance of Rs.15000/-per month.
          o Bonus/ex-gratis: Rs.85000/-per annum.
          o Compensation      of   Medical   Expenses   and/or   Medical   Insurance
             premiums for self and family members as per company’s policy.
          o Personal Accident Insurance as Per Company’s policy.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

     The power of modifying any issue i.e. increase or decrease the amount of the
 salary or any other and amount of perquisites to be provided by the company
 subject to a maximum ceiling of 100% of the salary of the whole-time Director will be
 in the hand of the Board of Directors, Whole-time Director shall also be entitled to
 following perquisites which shall not include in the computation of the ceiling on
 remuneration specified here in:

       o Contribution to Provident fund. Contributions to super annulations fund or
          annuity fund as per the rules of the company. These will not be included in
          the computation of the ceiling on perquisites to the extent these either
          singly or put together are not taxable under the Income Tax, 1961.
       o Gratuity payable at rate not beyond half a month’s salary for each
          completed year of service end.
       o Encashment of leave at the end of the tenure.
       o Provision of car for business of the company and telephone at residence
          shall not be treated as perquisites. Use of car for personal purpose and
          personal long distance calls on telephone shall be billed by the company.

        The Salary Payments
     Salary is usually paid in the first week of every month. Salary officer prepare
 covers with the name and personal code No., of employees and the pay slip along
 with cash or cheque as per grade.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

     • Mode of payment in cash or Bank Transfer

             Staff-       Cash option or Bank Transfer

             Officer-     Usually Bank Transfer.

     • The structure of the wages and the salaries

     The Human Resource Department also deals with wages and salary system.
 For the AIL the happiness and contentment of the employee’s is the main concern,
 which is reflected by the health wage and salary structure design in the company.
 The AARTI INDUSTRIES LIMITED pursues the minimum wage rate policy
 that is fixed by the Government.

         The salaries are also determined by the minimum wage rate policy which is
  set by the government.

     • The Salary Diminution

     The time office keeps the documentation of staff employees reporting at duty
 i.e. the time of entering and the time of leaving. If employees report late on job, in
 that case the company cuts the salary of that particular employee. The salary
 diminution rules as per the minutes that are delayed by the employee in reporting
 themselves to their respective departments are as follows:

     o If late by 16 min to 35 min    =     Pay of half hrs
     o If late by 35 min to 45 min    =     Pay of 45 min
     o If late by 46 min to 60 min    =     Pay of 1 hrs
     o If late by 2 hrs. to 3 hrs     =     Pay of half days

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

    • Enlightenment      :-
       o For the purpose of this agreement, “Family” means the spouse, the
          dependent children and dependent parents, if any, of the whole-time
          Director.
       o No sitting fee shall be payable to him for attending the meeting of the
          Board of Directors or committee thereof.
       o The other terms and condition of the agreement are such as are
          customarily contained in agreement of similar nature.

    • The Compensation Packages

       The compensation package includes:

       Basic + Dearness Allowance + other financial pays like cash canteen
   subsidies, washing allowance, shift allowance, contribution of provident fund,
   gratuity, medical charges, personal pays, inconvenience allowance, chemical,
   and hazardous allowance, etc.

    • Shift and Working Hours

    Timing at AARTI INDUSTRIES LIMITED the shifts are as follows:

     General shift 8:00 am to 5:00 pm on all working days.

     Lunch time is from 12:00pm to 1:00 pm and 1:00 pm to 2:00 pm.

     There are total 3 shifts in the company i.e. morning, evening, and night.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

  (Production of AARTI INDUSTRIES LIMITED goes on non stop i.e. continue
                                round the clock.)

     • The Industrial Act.

     The Industrial Acts that is applicable by Human Resource in the AARTI

  INDUSTRIES LIMITED is as follows.

       o Factory’s Act, 1948,

       o Industrial dispute Act, 1947,

       o Minimum Wages Act, 1948,

       o Employees provident funds and miscellaneous Act, 1942,

       o Payment of Bonus Act,1965,

       o Payment of gratitude Act, 1972,

       o Payment of wages Act, 1936,

       o The Worker men’s compensation Act,1923,

       o Apprentice Act,

       o The employees State Insurance Act, 1948,

       o Contract Labor Act,

       o Payment of Gujarat labor welfare fund.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

            FACILITIES PROVIDED TO THE WORKERS:
     The workers in the AARTI INDUSTRIES LIMITED are considered as an

 important part of the company and so the company sees that they provide their

 workers with the sufficient amenities for the betterment of the workers of their

 company.

      Alter the work method so that there is a reduction in any of the possibilities

        for straight handling of hazardous materials.

      Provide prospect to the workers to talk among them while they are working

        so that they can develop a healthy working relations among them.

      Ensure the availability of a qualified person for the proper treatment the

        workers and first aid equipment with all necessary ointments and medicines

        for each kind of infection that may be caused in a chemical industry.

      Performing of a regular fitness examination of the workers to notice whether

        they are in shape and able-bodied without any illness and if any worker

        found in such condition then provide them with ready contact treatment by a

        physician or a nurse.

      The company also tries to avoid the work of the workers which is in

        separation or in a remote area of the unit so as to avoid any kind of mishap.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                                     SCHEMES
     The schemes provided by AARTI INDUSTRIES LIMITED to their
 employees:

    EDUCATION SCHEME

     The Scheme decided by the AARTI INDUSTRIES LIMITED for the
 Scholarship for education to the children of all their employees. This scheme is for
 those children who have top score in their academic year. The scheme decides
 scholarship to the children on the basis of their merit.

     The applicability of the scheme is that the scheme will be applicable to all
 employees of the company and their children studying in STD. 5th to 12th. This will be
 free from any biasness from the AARTI’s side. And the deserving child will be
 getting the benefits of the scholarship scheme.

     After the submission of the concluding result by the children of their academic
 year to the specified personnel of AARTI the decisions will be taken. The results
 will be clustered as per the academic standard & the child who has topped will be
 sponsored for next year school fees. The approximate budget amount already set
 and given to the child will be Rs.32000 /-P.A. (Eight students every year x4000/-fees
 of each.)

    VOLUNTARY RETIREMENT SCHEME

     The Human Resource Department has also implemented a special type of
 policy for the employees named as Voluntary Retirement scheme. Under this
 scheme, if an employee is above 40 years of age and retire voluntary. He will be
 entitled to get the minimum 4 month salary excluding the benefit for the remaining
 years. And not many but only two employees have gone for this scheme.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

    MILK SCHEME

     At present AARTI INDUSTRIES LIMITED is giving milk coupons to all of
 its employees except some service department that are excluded from the scheme.
 Along with the milk coupons, AIL is giving tea allowance to all of its employees @
 Rs.4/- per attend.

    FUNERAL SCHEME

     The scheme is such that Rs. 2500/- to be given to all the employees on behalf of
 the society and AARTI INDUSTRIES LIMITED on expiry of any of the
 dependent family member. Company will compensate the amount to society. This is
 a small way to show the gratitude and the company’s concern towards the
 employee and their family.

    WELFARE SCHEMES FOR EMPLOYEES

     The AARTI INDUSTRIES LIMITED also provides some welfare schemes

 for their employees so that they can help their employees in some or the other

 ways.

         ∗ Med claim of employees,
         ∗ Personal accident,
         ∗ Employees D-link insurances scheme,
         ∗ Group gratuity scheme,
         ∗ School admission,
         ∗ Housing admission,

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

        ∗ Cycle loans,
        ∗ L.I.C through salary.

                      PERFORMANCE APPRAISAL

     Performance Appraisal is the procedure of evaluating employee’s performance

 of their employment in terms of their requirement for purpose of administration

 including placement selection for promotion need for training, providing financial

 rewards, etc. No firm has a choice as to whether it should or should not appraise

 their employees. Just as training is required to be endowed after recruitment of the

 employees, performance appraisal is also to be expected.

     In AARTI INDUSTRIES LIMITED, Confidential Method is used for

 performance appraisal of an employee. For the performance appraisal of the

 employee, the superior or head of the department prepares questionnaires, which is

 to be filled by their subordinates.    In this report the employee describes his

 strength, weakness, attitude to work, intelligence, attendance work efficiency, etc.

 With the help of this report, the top level can get the complete idea regarding the

 employee and his performance in the company. He can take decision regarding

 promotion, financial rewards, increments, etc. with the help of the information in the

 report. Whatever is the relation of the superior- subordinate they both have to asses

 each others performance with complete purity and without any biasness. The

 assessment of the executive done by their subordinates and that of the

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

 subordinates or the non-executive done by their executives will be again assessed

 by the superiors.

    OBJECTIVE OF PERFORMANCE APPRAISAL

     The objective of performance appraisal of the AARTI INDUSTRIES
 LIMITED is as follows

     o To determine increments and provide a reliable guide for promotion and
        transfer to positive of greater responsibility.
     o To suggest ways of improving the employees performance when he is not
        found to be up to the mark during the review period.
     o To maintain individual as well as group development by informing the
        employee of his performance standard.

 There are two types of appraisal program in the company.

        o Form A for the executive and
        o Form B for the non- executive

     There is no such procedure of the appraisal but the employees are assessed
 every at the end of every year. At the end of the year the performance appraisal
 program is conducted to know the performance of the employees over whole period
 under review. This review states that which employees who are efficient in their
 work and needs promotion and that the employees who are incompetent and who
 needs training to become effective in the work done by them.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                        SELF-APPRAISAL
                          (To be filled by Appraises)
   ?   What are the responsibilities of your job?

   ?   What do you consider the key areas of your present job?

   ?   In your view what are the major contributions/improvement made by you to

       the organization during the period under review

   ?   What are the areas where you could not achieve your desire goal? What were

       the reasons?

   ?   What would you consider as your important achievement, Contribution or

       improvements in the next 3 month, 6 months & one year?

   ?   What will be the action plan do you decided to achieve the target?

   ?   In order to achieve the specified targets that help do you need from the

       organization?

   ?   Are there any intimate problems (Personal or Organizational) which are likely

       to come in your way in achieving the enhanced target?

   ?   What co-ordination problems have you faced with your colleagues, other

       department, etc. in the organization? Your suggestions to improve the same.

   ?   What steps you have taken to improve the performance of your from

       donates? What do your propose to do in the next 3 to 6 months?

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

   ?   What training you had in last 12 months?

   ?   Do you have any suggestion for improvement in our organization?

   ?   Are you satisfied with your job, working condition and organization?

   ?   Do you think you need any training, Please specify?

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

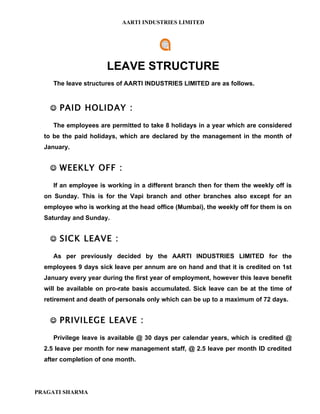

                      LEAVE STRUCTURE
     The leave structures of AARTI INDUSTRIES LIMITED are as follows.

     PAID HOLIDAY :

     The employees are permitted to take 8 holidays in a year which are considered
  to be the paid holidays, which are declared by the management in the month of
  January.

     WEEKLY OFF :

     If an employee is working in a different branch then for them the weekly off is
  on Sunday. This is for the Vapi branch and other branches also except for an
  employee who is working at the head office (Mumbai), the weekly off for them is on
  Saturday and Sunday.

     SICK LEAVE :

     As per previously decided by the AARTI INDUSTRIES LIMITED for the
  employees 9 days sick leave per annum are on hand and that it is credited on 1st
  January every year during the first year of employment, however this leave benefit
  will be available on pro-rate basis accumulated. Sick leave can be at the time of
  retirement and death of personals only which can be up to a maximum of 72 days.

     PRIVILEGE LEAVE :

     Privilege leave is available @ 30 days per calendar years, which is credited @
  2.5 leave per month for new management staff, @ 2.5 leave per month ID credited
  after completion of one month.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

     CASUAL LEAVE:

     Also the casual leaves are decided by the AARTI INDUSTRIES LIMITED
  9 days casual leave per annum is available per and it is credited every year on 1st
  Jan during the first year of employment, however this leaves benefit will be
  available on pro-rate basis. Since casual leave benefit cannot be carried to the
  next year, at the end of the calendar year the outstanding leave balance will
  automatically be encased and included in the salary of the subsequent month.

     SPECIAL LEAVE:

     The managing director under exceptional circumstances will have the prudence
  to grant any additional leave, termed as special leave to individuals. Such leave
  will normally be leave without pay, except it is for the benefit of the company.

     OTHER LEAVES:

     The other leaves are as follows they are the Maternity leave, leave after
  resignation compensatory leave unauthorized absence etc.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                            MEDICLAIM POLICY
     The AARTI INDUSTRIES LIMITED is among those fine companies for
 whom their employees mean a lot to them. The company always notices that all the
 facilities are properly made available to their employees or not. The AIL not only
 cares for their employees but also for their family.

      The scheme is such that the reimbursement of hospitalization expenses of
         the family member i.e. spouse children and dependent parents of the
         employee will be given the medclaim policy according to the policy of the
         AARTI INDUSTRIES LIMITED.
      The eligibility of this scheme is for all those who are voluntarily interested in
         this scheme and also for the permanent employees of the company who are
         not covered under ESIC scheme of AARTI INDUSTRIES LIMITED.
      The contribution for this scheme is monthly deduction of Rs. 20 per family
         member and per month from the salary of the employees and the same
         amount is to be contributed to the company.
      The conditions on this policy are as follows:

          •   Employee should notify the name and relation of the employee with the
              family member for which medical scheme is to be applied.
          •   All types of hospitalization expenses (i.e. medicine, expenses excluding
              food and convenience) are eligible for reimbursement.
          •   The proof of hospitalization should be cross checked i.e. the
              hospitalization and medications bills only.
          •   Reimbursement claim should be supported with doctor’s report and
              hospitalization and medications statement or bills only.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

        •   The reimbursement or the Payment of entire amount alleged for the
            parents mediclaim and any other will be paid after necessary enquiry
            and confirmation of matter and documents.
        •   The working of the department is that five members committee would
            be formed among the employee for the scheme with sanction of
            majority, for one year.

     Out of the members of committee two personals are authorized to pay the
       sum as per official mode. These members are having all the powers of
       scrutinizing the matters and checking of documents before giving the
       payment to employees.
     All the contribution collected from employees as well as from company on
       monthly basis is to be deposited in society in a separate bank account
       maintained for the purpose. All the claims should be settled out of the funds
       in decided bank account.
     Nature of expenses and diseases should be modified as per consideration
       of facts with the prior effects of six months from the date of amendments
       done.
     All the payments should be paid through cheque after authorization of all
       the committee members.
     Before finalizing the draft of the scheme, the scheme should be approved by
       the senior HRD personal of the company.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                        SOCIAL RESPONSIBILITY

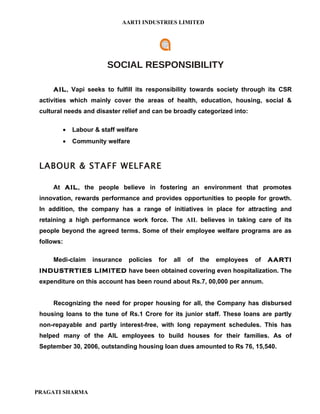

     AIL, Vapi seeks to fulfill its responsibility towards society through its CSR
 activities which mainly cover the areas of health, education, housing, social &
 cultural needs and disaster relief and can be broadly categorized into:

         •   Labour & staff welfare
         •   Community welfare

 LABOUR & STAFF WELFARE

     At AIL, the people believe in fostering an environment that promotes
 innovation, rewards performance and provides opportunities to people for growth.
 In addition, the company has a range of initiatives in place for attracting and
 retaining a high performance work force. The AIL believes in taking care of its
 people beyond the agreed terms. Some of their employee welfare programs are as
 follows:

     Medi-claim    insurance    policies   for   all   of   the   employees   of   AARTI
 INDUSTRTIES LIMITED have been obtained covering even hospitalization. The
 expenditure on this account has been round about Rs.7, 00,000 per annum.

     Recognizing the need for proper housing for all, the Company has disbursed
 housing loans to the tune of Rs.1 Crore for its junior staff. These loans are partly
 non-repayable and partly interest-free, with long repayment schedules. This has
 helped many of the AIL employees to build houses for their families. As of
 September 30, 2006, outstanding housing loan dues amounted to Rs 76, 15,540.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

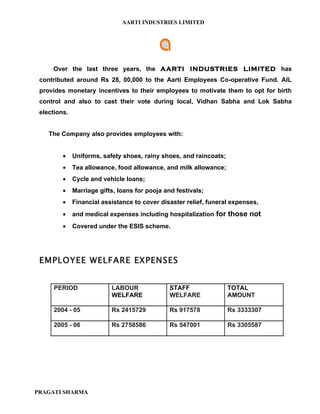

       Over the last three years, the AARTI INDUSTRIES LIMITED has
 contributed around Rs 28, 00,000 to the Aarti Employees Co-operative Fund. AIL
 provides monetary incentives to their employees to motivate them to opt for birth
 control and also to cast their vote during local, Vidhan Sabha and Lok Sabha
 elections.

     The Company also provides employees with:

           •   Uniforms, safety shoes, rainy shoes, and raincoats;
           •   Tea allowance, food allowance, and milk allowance;
           •   Cycle and vehicle loans;
           •   Marriage gifts, loans for pooja and festivals;
           •   Financial assistance to cover disaster relief, funeral expenses,
           •   and medical expenses including hospitalization for those not
           •   Covered under the ESIS scheme.

 EMPLOYEE WELFARE EXPENSES
Period Labour Welfare taff Welfare Total
Amount
        PERIOD                  LABOUR           STAFF               TOTAL
                                WELFARE          WELFARE             AMOUNT

        2004 - 05               Rs 2415729       Rs 917578           Rs 3333307

        2005 - 06               Rs 2758586       Rs 547001           Rs 3305587

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

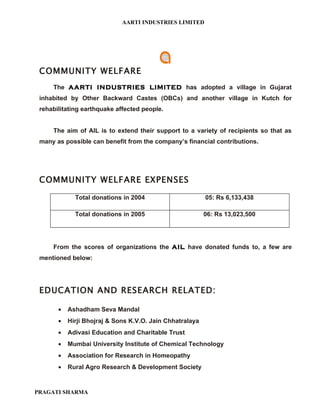

 COMMUNITY WELFARE
     The AARTI INDUSTRIES LIMITED has adopted a village in Gujarat
 inhabited by Other Backward Castes (OBCs) and another village in Kutch for
 rehabilitating earthquake affected people.

     The aim of AIL is to extend their support to a variety of recipients so that as
 many as possible can benefit from the company’s financial contributions.

 COMMUNITY WELFARE EXPENSES

             Total donations in 2004                      05: Rs 6,133,438

             Total donations in 2005                      06: Rs 13,023,500

     From the scores of organizations the AIL have donated funds to, a few are
 mentioned below:

 EDUCATION AND RESEARCH RELATED:

       •   Ashadham Seva Mandal
       •   Hirji Bhojraj & Sons K.V.O. Jain Chhatralaya
       •   Adivasi Education and Charitable Trust
       •   Mumbai University Institute of Chemical Technology
       •   Association for Research in Homeopathy
       •   Rural Agro Research & Development Society

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

 HEALTHCARE RELATED

      •   Vishwas Hospital Trust
      •   Shushrusha Charitable Trust
      •   Bidada Sarvodaya Trust
      •   Tibetan Medical and Astro Institute
      •   Hira-Mongi Navneet Hospital, Mulund
      •   Parakh Hospital, Ghatkopar

 SOCIAL WORK AND CULTURAL ACTIVITIES RELATED

      •   Kalgad Sarvodaya Trust
      •   Shri Wagad Sarvodaya Trust
      •   Dhanvallabh Charitable Trust
      •   Shri Vardhman Seva Sangh
      •   Geetai Mission
      •   Rovadan Trust
      •   People's Trust
      •   Child Relief and You (CRY) (working for underprivileged children)
      •   Kutch Mahila Vikas Sanghatan (involved with social empowerment of
          women)
      •   Shri Mulund K.V.O. Samaj
      •   Gandhi Labour Foundation
      •   Lion's Club of Mulund
      •   Giant's Group of Mandvi - Kutch
      •   Gramin Vikas Samiti (involved with rural development)

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

      •   Gram Swaraj Samiti (involved with rural development)

      •   Kutch Yuvak Sangh (working for the development of rural youth)
      •   Ankleshwar Industrial Development Society
      •   Vapi Punjabi Charitable Foundation

 DISASTER RELIEF WORK RELATED

      •   The Prime Minister's National Relief Fund (Tsunami relief)
      •   The Gujarat Chief Minister's Relief Fund
      •   Bhojay Sarvodaya Trust (Earthquake relief in Kashmir)
      •   Kutch Navnirman Abhiyaan (Rehabilitation of earthquake affected people
          in Kutch)

     The village in KUTCH adopted by AARTI INDUSTRIES
                                    LIMITED

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

 SUPPORTING                 ECONOMIC                AND            INDUSTRIAL
 DEVELOPMENT IN VAPI

     At AIL, Vapi, they believe in actively co-operating with neighboring industries
 to address common concerns and solve Business-related problems. The Director of
 AIL, Mr. Kirit Mehta, is the President of the Vapi Industries Association
 (VIA). He leads the association and takes the necessary initiative for getting basic
 common facilities for the members. He also handles the task of making
 representations to various bodies for problems related to roads, water supply,
 electricity, pollution control, etc. that obstruct the smooth conducting of business.
 Mr. Mehta is well respected for his contributions towards the development of the
 chemical industries in Vapi.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

       CORPORATE SOCIAL RESPONSIBILITY POLICY
                      (CSR)
     At AIL, the Corporate Sustainability Department, consisting of a team of senior
 management headed by the company’s Managing Director, monitors the company’s
 CSR & sustainability strategies and their implementation. The department meets
 regularly to review compliance with the company's CSR policy across the different
 units and to take informed decisions on related key issues.

 CORPORATE GOVERNANCE

     At AIL, integrity, transparency and social responsibility form the core of their
 corporate behaviour and characterize the way in which they interact with all those
 who have a stake in the company’s success and with the world at large. For AIL,
 corporate governance is not a discipline imposed by a Regulator, but something
 that stems from the culture of an organization. The principles of corporate
 governance guide the company’s Board of Directors, management and the AIL’s
 people to create long term sustainable value for their stakeholders.

     AIL's Board of Directors consists of a team of technocrats, engineers and
 management graduates having rich experience of more than two decades in the
 Industry. AIL’s 12-member Board of Directors has both Executive and Non-
 executive Directors. The board also comprises of an environment consultant, a
 solicitor, an advocate and a chartered accountant as Independent Directors.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

      The AIL has two Board committees - the Audit Committee and the
 Shareholders Grievance Committee. The Board has laid down a Code of Conduct
 (posted on our website (www.aartigroup.com) for all the directors and senior
 management of the company.

      AIL's Corporate Governance framework ensures:

         •     Sound    corporate    practices   based    on   integrity,    transparency,
               accountability, fairness and professionalism - values that are important
               for sustained growth, increased efficiency and stakeholder confidence.
         •     Timely flow of information to the Board and its committees.
         •     A sound system of internal control and supervision of business
               operations.
         •     Commitment to good HR policies
         •     Independent verification of the Company's financial, and CSR &
               sustainability reporting
         •     Timely disclosure of information to all our stakeholders
         •     Compliance with applicable laws, guidelines and regulations

      The people at AARTI INDUSTRIES LIMITED commit themselves to
 Corporate Social Responsibility (CSR) by conducting their business activities
 ethically through a fair and balanced approach, and by being socially responsible
 and responding to legal, social & ethical issues arising from their commercial
 activities.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

     The people therefore pledge to work towards continual progress in the
 following areas:

       •   Respecting their organization's philosophy and striving to be recognized
           as a good and esteemed corporate citizen.

       •   Complying with legal requirements, wherever they operate.

       •   Developing and supplying useful & safe products and improving the
           quality of their products and services to be able to contribute to the
           progress of society.

       •   Conducting business transactions based on fair and free competition.

       •   Striving to make their workplace vibrant to become an employer of choice
           and focusing on acquiring advanced professional skills & expertise in their
           field of responsibility.

       •   Protecting the environment, optimizing resource consumption and
           ensuring the safety of their people.

       •   Supporting human rights, and actively communicating with the company’s
           stakeholders to understand and respect their interests, thus serving and
           contributing to their development.

       •   Achieving sustained growth and profitability.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

     At AIL, the people shall strive to promote CSR activities to maintain a balanced
 approach towards economic goals, safety, quality, the environment and the
 interests of society, through an effective monitoring of the company’s performance
 on key issues covered by the CSR programme.

     AARTI INDUSTRIES believe that these initiatives will help them achieve
 sustainable development and be recognized as a responsible corporate citizen,
 consequently enabling our company to emerge as a modern and global company.

 STRATEGY FOR CSR
     AARTI      INDUSTRY       has few strategies for embedding CSR & its
 sustainability into their business activities. The AIL’s strategies for integrating
 CSR & sustainability into their management processes and day to day activities are
 based on our core values and the principles of the UN Global Compact. The
 company people are aware that by making CSR & sustainability an integral part of
 their business strategy they will be able to protect the quality of the company’s
 business activities, their decision-making processes and their capacity to create
 value for their own company and also their valuable stakeholders.

     To reach out to AARTI INDUSTRY LIMITED employees, customers and
 communities and show their concern for the environment, the AIL:

       •   Emphasize that CSR is a shared responsibility for every member of the
           AIL family.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

      •    Reward creativity and leadership skills and provide ample opportunities
           for personal & professional growth.

      •    Promote team spirit and learning of new skills.
      •    Uphold human rights and the dignity of every employee.
      •    Act promptly on matters related to the health and safety of their people.
      •    Reduce operational costs through energy efficiency, recycling and
           innovative use of by-products.
      •    Focus on reducing our environmental footprint and greenhouse gas
           emissions.
      •    Invest in new technologies and produce innovative & sustainable
           products.
      •    React proactively to customer needs.
      •    Customize solutions to meet customer requirements.
      •    Improve our financial performance to ensure better returns.
      •    Conduct business with transparency and share vital information with
           stakeholders.
      •    Encourage    our   employees     to   actively    participate   in   community
           development activities.
      •    Respect the rights and needs of the communities we operate in.

     At AIL; they believe that these strategies will strengthen their platform for
 growth.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                  FINANCE DEPARTMENT

      INTRODUCTION
     “Financial Management is concern with the efficient use of an important
 economic resource, namely, Capital funds.”

      SCOPE FINANCE DEPARTMENT
     In AARTI INDUSTRIES LIMITED the Finance Department deals with the
 problems of rising funds and there effective utilization in the business. Various
 decisions regarding:

        •   Acquisition of assets.
        •   Specific form of assets where money to be invested.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

        •       Composition of its liabilities.

     Liabilities are covered under the scope of Finance Department. The three
 functions covered all most all finance functions of an organization. And effect the
 three major decisions they are:-

        o Investment Division
        o Finance Division

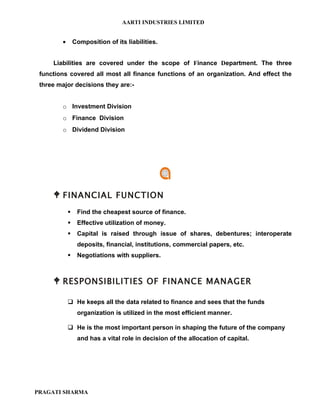

        o Dividend Division

      FINANCIAL FUNCTION
                Find the cheapest source of finance.
                Effective utilization of money.
                Capital is raised through issue of shares, debentures; interoperate
                 deposits, financial, institutions, commercial papers, etc.
                Negotiations with suppliers.

      RESPONSIBILITIES OF FINANCE MANAGER

             He keeps all the data related to finance and sees that the funds
                 organization is utilized in the most efficient manner.

             He is the most important person in shaping the future of the company
                 and has a vital role in decision of the allocation of capital.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

              Nowadays finance manager solves important management problem

             and his role is becoming pervasive and significant.

      FUNCTIONS OF FINANCE DEPARTMENT AT AIL

          Overhead payment like salary, wages etc.

          Cash management.

          Calculation of interest payment.

          Preparing bank reconciliation statement

          Payment like PF, income tax.

          Maintaining accounting record.

     In AARTI INDUSTRIES LIMITED Procure finance from the following
 Banks and finance Institutions:

         BANK OF BARODA
         UNION BANK OF INDIA
         STATE BANK OF INDIA
         ICICI. ETC

     ∗ Basis Of Acquiring Loans

        Banks and institutions give loans on basis of net – worth. (Net – Worth =
        Capital + Net Reserve)
        ESP = profit / No. Of Shares (Earning Per Shares)
        Current Ratio
        Dept – Equity Ratio

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

     ∗ Dividend Of Shares

           Board Of director decides the percentage of dividend.

           Percentage of dividend depends on profit.

           Dividend is not an expense but profit distribution.

     ∗ Short term sources

      I. Internal

           Depreciation funds

           Provision for taxation

           Accrued expenses

     II. External

           Bank credit

           Managing director or directors

    When a company is going to prepare any new project the company has to
 consider the following aspects.

              ¤ cost of project
              ¤ Means of finance
              ¤ Financial highlights
              ¤ Product and capacity
                       Sources of funds
                       Use of funds

              ¤ Projected performance

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

             ¤ Existing term loan commitments
             ¤ Existing W.C. facilities
             ¤ Proposed financial assets
             ¤ Introduction of product
             ¤ Company background
             ¤ Technical aspects
             ¤ Industry description
             ¤ Product description and demand supply position.

  STRUCTURE:-

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                                       CHAIRMAN

                                       MANAGING
                                       DIRECTOR

                                          VICE
                                        PRESIDNT

                                      GENERAL
                                      MANAGER

                 DEPUTY                                         ACCOUNT
                GENERAL                                         OFFICER/
                MANAGER                                          CASHER

                 FINANCE                                       ACCOUNT
                EXECUTIVE                                      ASSISTANT

     AARTI INDUSTRIES LIMITED had declared an interim dividend of 15%.
 The directors of AIL now recommend a final dividend of 21% for the year ended 31st

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

 march 2002. Total dividend for the year would thus be 36 % and the total dividend
 payment would be Rs. 418 lakhs subject to declaration of final dividend at Annual
 General Meeting.

      ACCOUNTING DIVISION:
           The books to be maintained in AARTI INDUSTRIES LIMITED are as
  follows:
       ∗   Sales accounting
       ∗   Purchasing accounting
       ∗   Bank Transition
       ∗   Cash Transition
       ∗   Debit notes
       ∗   Journal voucher

       From the above all books, the only description of some books are given below.

   RESPONSIBILITY OF FINANCE MANAGER

       ∗   He keeps all the data related to finance and sees that the funds organization
           is utilized in the most efficient manner.
       ∗   He is the most important person in shaping the future of the company and
           has a vital role in decision of the allocation of capital.
       ∗   Nowadays finance manager solves important management problem and his
           role becoming pervasive and significant.

          SALES ACCOUNTING

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

     Following is the sales procedure prevailing at the AARTI INDUSTRIES
LIMITED.

     Marketing department gets purchase order through negotiation.

            a. Indent is sent the dispatch section. Indent consist of terms of
                  payment, party’s name, details regarding the goods rate, excise, sales
                  tax transaction, credit period discount (if applicable).
            b. Dispatch section contract finish goods, stores so that they can supply
                  the necessary material.
            c. Finished goods stores communication with excise department and
                  they carry on their necessary procedure.
            d. Preparation of sales registers, ledger account, trail balance, etc. Sale
                  keeps management information system (MIS).

       MIS contains information relating to receivable and sales-product wise and
 quantity wise.

     PURCHASE ACCOUNTING:

  Flow and documents in purchase accounting is as follows:

     Step 1
         To receive all invoice from purchase department.
         To receive all M.R.N. from stores department.
         To receive all purchase order from purchase department.

     Step 2
         To match this document with each with each other.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

        To attach copy of P.O and MRN with invoices.

       Step3
        To process the invoice after comparing the same with MRN and PO.
        To forward the document to senior manager for management check.

       Step 4
        Executive to hire second check to ensure correctness and accuracy.
        To put his/her initials on the rubber stamp at the place market for the
            purpose.
        To forward the document to senior manager for management check.

       Step 5
        Senior manager to check the document from various angles to ensure
            total control.
        To put his/her initials on the rubber stamp at the place marked for the
            purpose.
        To forward the document to account assistant for data entry.

       Note:-
           Dispatch section on receiving the purchase order co-order with production
   department so that the production can be on line with the demand of the
   products.

    BANK TRANSACTION OPERATION OF BANK ACCOUNT:-
     AARTI’s major bankers are:
       ∗    Bank of Baroda,

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

       ∗   Punjab national bank,
       ∗   Dena bank.

           Performs:
        Maintenance of current account
        Maintenance of cash credit account over draft facility.
        Preparation of BRS (bank reconciliation statement) every month.

    CASH BOOK
       Performs:
        Petty cash book which petty cashier operates.
        Main cash book which dose main cashier operator.

       Note:
           According to the income tax act if the amount exceeds, rupees twenty
    thousand then it must be paid by cheque.

    OTHER INFORMATION:

        Corporate dividend tax means tax on dividend payable by the corporate.
        Percentage of transfer to general reserve is based on criteria decided by
           company’s Act.
        Deferred liability means liability, which is to be paid at later stage.
           Rate of department according to income tax is different than that of
           company act.
        Department not the actual expense but hidden profit.

           Balance sheet of AARTI INDUSTRIES LIMITED
                           As on 31st march 2005.

    Liabilities           Amounts                Assets                        Amounts
 SHAREHOLDERS’                          FIXED ASSETS

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

 FUND
                                        Gross Block
 Share capital              364047120                              3772152761
                                        Less: Depreciation
 Equity share warrants       18456460                            1476802108

 Reserves and Surplus      2004085241 =Net Block                                 2295350653
                                        Capital Work in progress                  279752107
 LOAN FUNDS
 Secured loans             2883205497 INVESMENT                                   247421512
 Unsecured loans            120956656
                                        CURRENT ASSEST,
 DEFERRED TAX                           LOANS AND ADVANCES
 LIABILITY               260207942                                 4282512765
                                        LESS:
                                        CURRENTLIABILITIES
                                        AND PROVISIONS
                                                                 1469337743

                                        Net Working Capital                      2813175022

                                        MISCELLANEOUS
                                        EXPENDITURE
                                        (To the extent not written off or
                                        adjusted)
                                        Pre-operative Expenses                         NIL
                                        Deferred Revenue Expenditure               15259622

 TOTAL                   5650958916 TOTAL                                       5650958916

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

      Profit & Loss Account for the year ended 31 st
                      March, 2006

 INCOME
 Income from operation                                        7,861,750,467
 other income                                                 47,810,802
 Increase in inventory                                        220,512,506

 TOTAL                                                        8,130,073,775

 EXPENDITURE
 Manufacturing Expenses                                       5,765,521,854
 Purchase of Goods Traded In                                  601,311,395
 Office and administration Expenses                           86,832,124
 Selling and Distribution Expenses                            518,133,693
 Interest and financial Charges                               204,004,164
 Non-Operating Expenses and losses                            16,244,538

 TOTAL                                                        7,192,047,768

 Profit Before Depreciation                                   938,026,007
 Less: Depreciation                                           221,869,002
 Profit Before Tax                                            716,157,005
 Less:Provision for taxation(including fringe benefit tax)    162,300,000
 Profit After Tax                                             553,857,005
 Less: Provision for Deffered Tax                             63,213,480
 Profit After deffered Tax                                    490,643,525
 Add: Balance of Profit and Loss Account Brought Forward      1,537,363,110
 Add: Provision for Diminution in the value of Investments-
 Quoted                                                       NIL
 Less: Prior Years' adjustment for others                     18,520,032
                                                              2,009,486,603
 less:Transfer to General Resereve                            50,000,000
                                                              1,959,486,603
 Less:Dividend                                                61,888,011
 Less:Dividend                                                50,966,597
 Less:Proposed Dividend                                       29,123,770
 Less:Tax On Dividend                                         19,912,468

 Balance Carried Forward To Balance Sheet                     1,797,595,757

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

  Earning Per Share                                            6.74

                             RATIO ANALYSIS
      A Ratio is simply one number expressed in terms of another, it is an expression
 of relationship spelt out by dividing one figure by another. The ratio analyses of the
 AARTI INDUSTRIES LIMITED are as follows:

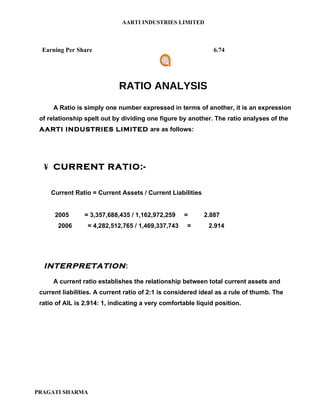

  ¥ CURRENT RATIO:-

     Current Ratio = Current Assets / Current Liabilities

      2005       = 3,357,688,435 / 1,162,972,259    =       2.887
       2006       = 4,282,512,765 / 1,469,337,743    =       2.914

  INTERPRETATION :

      A current ratio establishes the relationship between total current assets and
 current liabilities. A current ratio of 2:1 is considered ideal as a rule of thumb. The
 ratio of AIL is 2.914: 1, indicating a very comfortable liquid position.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

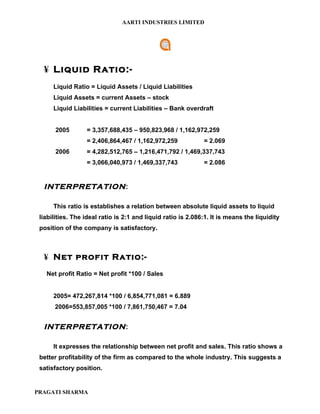

  ¥ Liquid Ratio:-
      Liquid Ratio = Liquid Assets / Liquid Liabilities
      Liquid Assets = current Assets – stock
      Liquid Liabilities = current Liabilities – Bank overdraft

       2005       = 3,357,688,435 – 950,823,968 / 1,162,972,259
                  = 2,406,864,467 / 1,162,972,259             = 2.069
       2006       = 4,282,512,765 – 1,216,471,792 / 1,469,337,743
                  = 3,066,040,973 / 1,469,337,743             = 2.086

  INTERPRETATION :

      This ratio is establishes a relation between absolute liquid assets to liquid
 liabilities. The ideal ratio is 2:1 and liquid ratio is 2.086:1. It is means the liquidity
 position of the company is satisfactory.

  ¥ Net profit Ratio:-
   Net profit Ratio = Net profit *100 / Sales

      2005= 472,267,814 *100 / 6,854,771,081 = 6.889
      2006=553,857,005 *100 / 7,861,750,467 = 7.04

  INTERPRETATION :

      It expresses the relationship between net profit and sales. This ratio shows a
 better profitability of the firm as compared to the whole industry. This suggests a
 satisfactory position.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

  ¥ Return on capital employed:-

  Return on capital employed = Net profit *100 / Share capital +
                                       Reserves & Surplus + Long term loan

       2005                  = 472,267,814 *100 / 2,249,124,783
                             = 20.997
       2006                  = 553,857,005 *100 / 3,004,162,153
                             = 18.436

  INTERPRETATION :

     The standard return on capital employed is about 15%. Return on capital
 employed ratio is 18.436%. These indicate the higher productivity of the capital
 employed.

  ¥ Debt Equity Ratio:-

 Debt Equity Ratio = Long term debt / Shareholder’s fund

     2005        = 2,249,124,783 / 2,057,899,714    = 1.092
    2006        = 3,004,162,153 / 2,386,588,821    = 1.258

  INTERPRETATION :

      It expresses the relationship between debt and equity. The standard debt-
 equity ratio is 2:1. It means for every 2 share there is 1 debt. The debt-equity ratio is
 125.8%, this indicates that the states of long-term creditor are move and indicates
 week financial structure.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

  ¥ Capital Turnover ratio:-

 Capital Turnover ratio = Net sales / Total Capital Employed

     2005            = 6,854,771,081 / 4,504,018,959     = 1.521
      2006           = 7,861,750,467 / 5,650,958,916     = 1.391

  ¥ Return on Share holder’s fund:-

  Return on Share holder’s fund = Earning after tax *100 /
                                       Share holder’s fund

    2005          = 472,267,814 *100 / 2,057,899,714    =22.95%
    2006          = 553,857,005 *100 / 2,386,588,821    =23.20%

  ¥ Fixed Assets Turnover ratio:-

   Fixed Assets Turnover ratio = Net sales / Net Block

     2005        = 6,854,771,081 / 1,861,448,777    = 3.682
     2006        = 7,861,750,467 / 2,295,350,653    = 3.425

  INTERPRETATION :
      The ratio establishes a relationship between the fixed assets and sales. The
 standard fixed turnover ratio is 5 times. A high ratio indicates better utilization of
 fixed assets. A low ratio indicated under utilization of fixed assets. So the
 company’s ratio indicates under-utilization of fixed assets.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

  ¥ Net Working Capital Turnover Ratio:-

 Net Working Capital Turnover Ratio = Net sales / Net Working Capital

   2005        = 6,854,771,081 / 2,194,716,176    = 3.123
   2006        = 7,861,750,467 / 2,813,175,022    = 2.794

  INTERPRETATION :

      The term working capital refers to excess of current assets over current
 liabilities. This ratio establishes a relationship between working capital and sales.
 This ratio enables to know efficient utilization of working capital of an organization.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

 Shareholding Pattern of AARTI INDUSTRIES LTD as
                    On 31st March 2006

   AUTHORIZED CAPITAL:-

    9, 00, 00,000 Equity Shares of Rs. 5/- Each

   ISSUED, SUBSCRIBED & PAID-UP:-

    7, 28, 09,424 Equity Shares of Rs. 5/- Each fully paid up

   MARKET PRICE DATA:-

        Month           Bombay Stock Exchange               National Stock Exchange
                    High(Rs.) Low(Rs.) Volume High(Rs.) Low(Rs.) Volume
       Jan 2006       165.80       76.50      513468      165.90     78.55    1029720
       Feb 2006        82.20       72.05      538856       82.25     73.50    579879
      Mar 2006         85.00       73.00     1422548       86.00     74.00    1098204

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

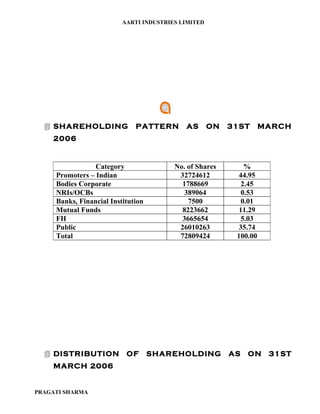

   SHAREHOLDING              PATTERN       AS       ON   31ST      MARCH
    2006

                 Category                No. of Shares        %
     Promoters – Indian                   32724612          44.95
     Bodies Corporate                      1788669           2.45
     NRIs/OCBs                              389064           0.53
     Banks, Financial Institution            7500            0.01
     Mutual Funds                          8223662          11.29
     FII                                   3665654           5.03
     Public                               26010263          35.74
     Total                                72809424         100.00

   DISTRIBUTION           OF       SHAREHOLDING          AS   ON    31ST
    MARCH 2006

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

         No. of           Shareholders                Share Held
         Shares
                      Number          %          Number         %
      Less then 500    8713          54.06       1619101       2.22
        501-1000       3519          21.83        2355917       3.24
       1001-2000       2726          16.91        3539829       4.86
       2001-3000        321           1.99         845174       1.16
       3001-4000        152           0.94         554790       0.76
       4001-5000         84           0.52         381802       0.52
      5001-10000        232           1.44        1655480       2.27
      Above 10000       370           2.30       61857331      84.96
          Total       16117         100.00       72809424     100.00

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                                             CHARTS

   € TOTAL INCOME

                                    Total Income
            )
                                                               790.96
            es
            or   800                                  688.06

            Cr   700
                                             511.59
                 600
            in                     474.32                                   Series1
            es   500     345.85
            pe   400
            u    300
                 200
            (R
                 100
                   0
                       2001-02 2002-03 2003-04 2004-05 2005-06

                                            Years

   €   EARNING PER SHARE

                                           Earning Per share

                         35                              30.02
                         30                   24.39
                                   23.06
                         25
                         20
        (Amount in Rupees)
                                                                   12.78*
                         15
                         10                                                 6.74#

                          5
                          0
                              2001-02 2002-03 2003-04 2004-05 2005-06

                                                       Years

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

   € PROFIT BEFORE & AFTER TAX

                                     Profit Before & After Tax

                  80                                                      71.62
                  70
                                                               58.23              55.39
                  60                               50.06              47.23
                  50                 41.05             39.56
       (Rupees in Crores)  32.87
                  40                      31.55
                               29.12
                  30
                  20
                  10
                   0
                           2001-02     2002-03     2003-04    2004-05     2005-06

                                                   Years

   € DIVIDEND PAYOUT

                                        Dividend Payout

                   30                                             25.95
                                           25.00                              25.64
                   25                                 23.00

                   20
     Payout (%)                                                           14.2
                   15                                         12.26
                                8.33                9.10
                   10                   7.89

                       5    2.43

                       0
                           2001-02     2002-03     2003-04     2004-05    2005-06

                                                   Years

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

   €      NET WORTH

                                                 Net worth
                                                                                  235.29
                     250
                                                                     203.95
                     200                                 172.29

                                             144.56
                     150
       (Rupees in Crores)        123.75

                     100

                      50

                       0
                               2001-02     2002-03     2003-04     2004-05      2005-06

                                                       Years

   € BOOK VALUE

                                               Book Value

                      160                                 141.97
                      140                     119.13
                      120         101.98
                      100
       (Amount in Rupees)
                       80                                              56.03*
                       60
                                                                                   32.32#
                       40
                       20
                           0
                                2001-02     2002-03     2003-04     2004-05      2005-06

                                                         Years

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                MARKETING DEPARTMENT 
 INTRODUCTION OF MARKETING
     The dictionary definition of Marketing is selling, advertising, promotion, etc.
 Marketing affects our day to day life in whatever we do right from buying vegetables
 clothes or grocery items. The most eye-catching and best quality is that towards
 which everyone is attracted. And to make the product eye-catching and sell your
 product in the market what you need to do is marketing of your product.

     Marketing is nothing but a consequence of a cautious planning which is to be
 done by the people of the company for making their product a success and that to
 sell or market their product in the market. Things done with awareness and
 complete homework with all the right calculations and complete knowledge the new
 developments and happenings in the market would result in the excellent marketing.
 Nowadays the organizations have started concentrating on the different ways in
 which they can cater a maximum number of the customers and also how they can
 promote their products.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

     The same is in the case AARTI INDUSTRIES LIMITED. The AIL tries its
 best to satisfy their customers by providing with the best quality products. AIL
 considers quality of its products as the company’s biggest strength. The AIL by
 giving the proper amount of pricing of its products is able to cater a good amount of
 customers for the company.

     The consumers are at the present time are becoming more and more aware of
 the products availability. The customers are becoming choosy and not only
 concentrate on the products quality but also on how the companies present their
 products in front of them. The customers very carefully observe the features,
 design, pricing, and others. By observing each of the details of the product the
 customers tries to make perception of the product and then try the product. In
 todays competitive world satisfaction of the customer is the most important job of
 the companies. So in today’s time the marketing is done according to the needs
 wants and the demands of the customers so that whatever the customers needs
 that is produced to make the customers satisfied.

     AARTI chemical is basically manufacturer of chemical products and the
 company has a number of chemicals that are manufactured in the company. Being a
 chemical company, consumers may not be directly using AIL's products, and it
 may be difficult to see how the chemicals the AIL produce enrich the lives of
 people. But the AARTI INDUSTRIES do contribute towards improving their
 quality of life since the end users of their products are industries ranging from
 agrochemicals and dyes to speciality chemicals and pharmaceuticals - markets that
 are critical to long-term sustainability. By supplying high quality and good value
 products to their customers, the AARTI INDUSTRIES LIMITED indirectly help

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

 people to have access to better medicines, fertilizers and diverse items of daily use.
 In other words, greening the supply chain management plays a significant role in
 AIL’s business strategy.

     AIL`s prime activity is to manufacture organic chemicals, mainly benzene-
 based intermediates. They also manufacture sulphuric acid and allied products,
 which provide basic building blocks to most sectors of the chemical industry.

     As the companies seeks for the company who provide quality products and
 that the quality products are been produced by the AIL. AARTI INDUSTRIES
 being a chemical manufacturing company manufactures benzene based products
 and that the distribution of the products of the company is as follows:

         o 50% exported
         o 30% for sister concern
         o 20% other companies

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

     50%   of the manufacturing of AIL’s products is exported to the foreign
       countries.

     30% of the AIL’s products is used by the sister concern of the AIL.
     20% of the manufacturing of the AIL is being sent to the Indian market.

       THE COMPETITORS OF AARTI INDUSTRIES
                     LIMITED.
    The competitors of AARTI INDUSTRIES LIMITED are as follows:
           Alankar Industries
           Anami Organics
           Apurva chemical
           Chirag Organics Pvt Ltd
           Kamala Intermediates
           Nascent Chemical Ind. Ltd
           Micro Fine
           Shanti Intermediates Pvt Ltd.
           Vapi Acid & chemicals
           Vapi Organic Chemical Pvt Ltd

                      THE CUSTOMERS OF AIL

    The customers of the AIL are many in India as well as in the abroad.

     NAME OF THE COMPANY                              PRODUCT

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

   Dr Reddy                                                 DMS
   Bharat chemicals                                        PNCP
   Sister concern                                    Drugs & Organics

      While trading abroad the AARTI INDUSTRIES LIMITED markets its product to
 the European countries the most.

      During the year under review, the company has achieved Sales turnover of Rs.
 786.18 crores. While in the previous year the sales turnover was Rs. 685.47 crores,
 registering a growth of 14.69%.

                          THE SUPPLIERS OF AIL

      There are many companies in the suppliers list of the AIL but some of them
 companies that supply chemical raw materials to AIL are as follows:

          NAME OF THE COMPANY                          PRODUCT
        Standard Alkaline GSC                             Chlorine

        Reliance Jamnagar & Hajare                        Benzene

        Deepak nitrite                                    nitric Acid

        Udaipur                                       rock phospect

  •   Reliance Industries Ltd.
  •   Bharat Petroleum Corporation Ltd.
  •   National Organic Chemical Industries Ltd.
  •   Standard Albalies Ltd.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

  •   National Rayon Corporation Ltd.
  •   Grasim Industries.
  •   Gujarat Narmada Valley Industries Corporation.
  •   Deepak Nitrate ltd.
  •   Transport ltd Dubai.
  •   Helm Chemicals Germany
  •   Universal Chemical Bahrain.

      THE STRUCTURE OF AARTI INDUSTRIES LIMITED
            (AIL) OF MARKETING DEPARTMENT

                            THE MANAGING DIRECTOR

                             BOARD OF DIRECTORS

                             MARKETING MANAGER

                                 SALES MENS

 THE MARKETING OBJECTIVE OF AIL
       The marketing objective of the AIL are

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

        •   To make awareness of their product.
        •   To become the leader of chemical manufacturing products.
        •   To earn profit.
        •   To have maximum sales of their product with maximum customers.
        •   Enhancing economic growth
        •   Strengthening social responsibility
        •   Intensifying environmental commitment
        •   Ensuring a better tomorrow

      THE HOLISTIC MARKETING APPROACH OF AIL
     The traditional way of thinking of the people was marketing is to sell their
 product in the market. But with the passage of time the companies have started
 thinking in a broad manner now the most important thing for them is to retain their
 customer and make a different and a good position of their company in the market.
 For that the companies have started adopting the holistic marketing concept.

     The holistic marketing concept takes in view not only the customers but also
 the relationship of the company with their customers, stakeholders, their
 management and the department and each of their other links prevailing in the
 market. With all of these maintaining a position in the society is also one of the
 important matters.

     The AARTI INDUSTRIES LIMITED has maintained a very good relation
 with their employees, customers, stakeholders, as well as the society which can be
 seen in the welfare done by the AIL.

     THE HOLISTIC MARKETING MODEL
                      INTERNAL                           INTEGRATED

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                                         HOLISTIC
                                        MARKETING

                      SOCIALLY                            RELATIONSHIP
                     RESPONSIBLE

      We can say that AARTI INDUSTRIES LIMITED also follow the holistic
 marketing concept is by the following reasons.

  INTERNAL:

      The AIL takes care of their employees in a proper way. Right from their senior
 management to their employees and staff. Everyone is treated as if a family. The AIL
 takes care of the needs and the wants of the employees and that the employees in
 return work efficiently and effectively. Also the strategies, principles, recruitment,
 selection, and motivation to the employees are done very carefully of each and
 every department.

  INTEGRATED:

      The integrated marketing is the marketing where the task of the marketing of
 the products is done. The marketing mix is an essential part of marketing and the 4
 P’s is well considered here (Marketing Mix explained in the later part). So the AIL
 tries its best to develop its marketing mix.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

  SOCIALLY RESPONSIBLE:

      In today’s world being socially responsible is very important. The AIL has tried
 its best to be a socially responsible company by maintaining the ethics and moving
 on with the environment al, legal and the community trends of the place it is
 situated.

  RELATIONSHIP MARKETING:

      The relationship marketing is maintaining the relationship with the customers
 stakeholders, suppliers distributors etc, and being loyal to each of them. The AIL is
 among those companies who does the relationship marketing as the AIL not only
 maintains the relationship with each of them but also treat them as their family
 whether the customers suppliers distributors are oft the local market or of the
 foreign market.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

            THE ENVIRONMENT THAT AFFECT THE
                       COMPANY
     The company is to be found facing many different environment that affect the
 company adversely these environments are the classified under the two
 environments they are:

        •   The internal environment and
        •   The external environment.

 The internal environments that affect the company are as under

      The customers

            The public and the customers are the key factor which may prove fruitful
            as well as harmful. The customers if properly satisfied would demand
            more products and make the company reach at the top but if they are not
            satisfied then the company may even shut down. In AIL the customers
            are seen as the key part so if they are not satisfied then the company will
            have to face problems.

      The suppliers

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

           The suppliers are also an important part as the suppliers are the people
           who provide us with the basic raw materials so if they are not with the
           company then the company will face problems. If these people are not
           satisfied on time then the company would face many problems.

      The competitors

           Competitors are that part of the company which would affect the
           company adversely. As the competitors increase or decrease the price
           range or any sort of new innovation that the competitors company does
           will have a direct effect on the company itself. (AARTI INDUSTRIES
           LIMITED)

  The external environments that affect the company are as under

      The technological environment

           The technology plays a vital role for a company as if the technology
           adopted by the company is old and that the competitor has the
           technology which is new and involves less amount of money and so the
           competitors if they gain the advantage before the company itself then the
           competitors will gain a competitive advantage and the will not be able to
           achieve the position which the company desires.

      The political / legal environment

           The political environment is pertaining to the government. If he
           government makes any policy which is not in the favor of the company
           like increasing the tax rate, increase the export-import duties, or put

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

           more duties on the goods so the company will have to spend more and
           this will affect the company adversely.

 CORE COMPETENCIES

  The core competencies of AIL are as follows:

            Quality and Logistics,
            Continuous Cost Control,
            High Value Addition,
            Diversified Product Range,
            Loyal Work Force,
            In - House R&D,
            Customer Satisfaction.

 AARTI INDUSTRIES LIMITED’S CORPORATE VISION

      •   To retain leadership in the domestic market.
      •   To attain a significant presence in global markets.
      •   To become suppliers of choice to leading customers.
      •   To be always committed to employees, customers, shareholders, and
          society at large.

 AARTI INDUSTRIES SUSTAINABLE GROWTH MISSION

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

      •       To become one of the most respected organizations in the chemical
              industry and a name people trust through quality products and sound
              corporate values.
      •       To grow into a large corporate entity by increasing the company’s reach to
              newer global markets, and expanding the company’s product line up
              through new product developments.

      •       To use cost-effective and innovative manufacturing methods supported by
              proven, eco-friendly and safe technologies.
      •       To become a customer-driven company by providing customized solutions
              and services to meet changing customer requirements.
      •       To encourage and nurture a winning organizational culture by focusing on
              providing their people opportunities for personal and professional growth.
      •       To maintain a balance between the company’s corporate goals and social
              responsibilities.
      •       To create long-term, sustainable growth for all the company’s stake-
              holders.

    THE MARKETING MIX OF AARTI INDUSTRIES
                  LIMITED
    The marketing mix is made up of four elements namely the

          •    Product,
          •    Price,
          •    Place, and

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

              •   Promotion.

        Let us see the marketing mix of AARTI INDUSTRIES LIMITED one by
 one.

 PRODUCT:-
    Product is anything that is offered to a market to satisfy a want or their needs.
 The product having nearly all quality, performance, or innovative features are
 generally easily accepted by the customers. So a product should possess all of
 these qualities so as to retain their customers for an extended time. The products of
 the AARTI INDUSTRIES are in the maturity stage of the product life cycle. As in
 the maturity stage sales of the product is not too high and not low so the same is in
 the case of the AARTI INDUSTRIES product the products sales are not too high
 and not too low.

        The product portfolio of AARTI CHEMICALS LIMITED portfolio consists
        of:

              1) BENZENE-BASED INTERMEDIATES

              2) SULPHURIC ACID & ITS ALLIED PRODUCTS.

              3) AGROCHEMICALS & FERTILIZERS

              4) ACTIVE PHARMACEUTICAL INGREDIENTS (APIs)

              5) OTHER INTERMEDIATES & SPECIALITY CHEMICALS

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

    THE PRODUCT LINE AND PRODUCT DEPTH

       Para Nitro Chloro Benzene (PNCB)

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

       •

       •

       •

       •

       •

       •

       •

       •

       •

       •

       •

       •

       •

       •

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

       Ortho Nitro Chloro Benzne (ONCB)

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

       •

       •

       •

       •

       •

       •

       •

       •

       •

       •

       •

       •

       •

       •

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

       Dinitro Chloro Benzene (DNCB)

       •

       •

       •

       •

       •

       Para Dichloro Benzene (PDCB)

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

       •

       •

       •

       •

       •

       •

       •

       •

       •

       •

       •

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

       Ortho Dichloro Benzene (ODCB)

       •

       •

       •

       •

       •

       •

       •

       •

       •

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

       Nitro Benzene

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

       •

       •

       •

       •

       •

       •

       •

       •

       •

       •

       •

       •

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

       Alkylated Anilines & Toluidines

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

       •

       •

       •

       •

       •

       •

       •

       •

       •

       •

       •

       •

       •

       •

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

       Chloro Phenols

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

       •

       •

       •

       •

       •

       •

       •

       •

       •

       Fluoro Compounds

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

       •

       •

       •

       •

       •

       •

       •

       •

       •

       •

       •

       •

       •

       •

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

       Agrochemicals

       •

       •

       • Other Major Products

           Bulk Drug Intermediates / Speciality Chemicals

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

        •   4 - Nitro Aniline (Para Nitro Aniline)-100-01-6

        •   Ortho Chloro Aniline (95-51-2)

        •   2- Chloro Nitro Benzene (Ortho Nitro Chloro Benzene) (88-73-3)

        •   Ortho Anisidine (90-04-0)

        •   Ortho Phenylene Diamine (95-54-5)

        •   Di Methyl Sulphate (DMS)

        •   2,5 Dichloro Nitro Benzene (2,5 DCNB) (89-61-2)

        •   4- Chloro 2- Nitro Aniline (Para Chloro Ortho Nitro Aniline) (89-63-4)

        •   Para Chloro Ortho Anisidine (93-50-5)

        •   1,2 Dichloro Benzene (Ortho Dichloro Benzene) (95-50-1)

        •   1,3 - Dinitro Benzene (Meta Di Nitro Benzene)

        •   Meta Phenylene Di Amine

        •   N,N Di Ethyl Meta Toluidine (DEMT)

        •   4-Chloro Phenol (PCP)

        •   2,3 Di Chloro Phenol

        •   3:4 Di Chloro Phenol

        •   Mono Chloro Benzene (MCB)

        •   Meta Di Chloro Benzene

        •   Mono Chloro Benzene Para Sulphonic Acid

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

          Bulk Pharmaceuticals

          DYES

                             DYES AVAILABLE IN LIQUID FORM

                                      ACID BLUE 15
                                     ACID VIOLET 17
                                     ACID VIOLET 49
                                    ACID BLACK 194
                                    BASIC YELLOW 2
                                    BASIC VIOLET 1
                                    BASIC VIOLET 3
                                    BASIC GREEN 4
                                    BASIC GREEN 1

          Bulk Drugs under R & D
        Anti-Hypertensives   Anti-Cancer

        Perindopril          Imatinib Mesylate
        Trandolapril         Capcetabine
        Cilazepril           Irenotican

        Bronchodilators      Anti-Diabetic

        Loteprednol          Glimepiride
        Mometasone
        Ciclesonide
        Flumethasone         Anti-Deprresents
        Desonide
                             Ziprasidone
                             Aripiprazole
                             Zaleplon
                             Paroxetine HCL

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

         Dyes

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

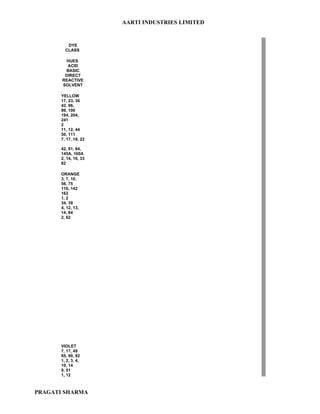

           DYE
          CLASS

        HUES
         ACID
        BASIC
        DIRECT
       REACTIVE
       SOLVENT

      YELLOW
      17, 23, 36
      42, 96,
      99, 100
      194, 204,
      241
      2
      11, 12, 44
      50, 111
      7, 17, 18, 22

      42, 81, 84,
      145A, 160A
      2, 14, 16, 33
      82

      ORANGE
      3, 7, 10,
      56, 75
      116, 142
      162
      1, 2
      34, 39
      4, 12, 13,
      14, 84
      2, 62

      BROWN
      75, 160
      165, 355
      365
      1

      9

      RED
      18, 52, 73,
      81, 88, 97,
      119, 131,
      151, 186
      195, 283
      357, 362

      23, 80, 81
      11, 35, 49,
      141
      152, 180A
      195A, 196
      1, 23, 24, 49

      VIOLET
      7, 17, 49
      85, 90, 92
      1, 2, 3, 4,
      10, 14
      9, 51
      1, 12

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

 QUALITY
      Quality is one of the important and basic aspects of marketing. Being a
 chemical company, consumers may not be directly using AIL's products, and it
 may be difficult to see how the chemicals they produce enrich the lives of people.
 But the AIL do contribute towards improving the people’s quality of life since the
 end users of their products are industries ranging from agrochemicals and dyes to
 speciality chemicals and pharmaceuticals - markets that are critical to long-term
 sustainability. By supplying high quality and good value products to their
 customers, AIL indirectly help people to have access to better medicines, fertilizers
 and diverse items of daily use. In other words, greening the supply chain
 management plays a significant role in their business strategy.

 DESIGN AND FEATURES

      As the product is chemical the design and the features is not possible. The
 products (chemicals) in the AIL are either in the powdered form or in the liquid
 form.

 SIZES
      For the solid form, the plastic gunny bags have the minimum size of about 50
 kg and the maximum above 450 and this is mostly used for the local market
 packaging and the demand of the customers. For the export purpose he plastic
 gunny bags are only used but the size of the gunny bag differs. The size turns to be
 500 kg when it is sent to the foreign customers.

     For the liquid form the containers are used. These containers are packed in
 such a way that the chemical does not react with the drums. These drums are of
 different sizes

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

 BRAND NAME
     The product i.e. the chemical is marketed in the market in the brand name of
 AARTI INDUSTRIES LIMITED (AIL) in INDIA as well as in the foreign
 markets

 SERVICES
     The services offered by the AARTI INDUSTRIES to its customers after
 their customers receive the order are as follows:

           o Product information,
           o Safety data sheets,
           o Instructions for the of the product if facing any problem,
           o Product handling guidance.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

 PRICE:-
      In what ever we do we do pay price for it. When we purchase certain things, we
 make certain things and also that ethically when we are wrong and do anything bad
 we pay price for that.

      Previously the pricing used to be set with the negotiations of the buyers and
 the sellers. The price for which both of them agree used to be the price of the
 product. Though at that time also bargaining prevailed but coming up to a price with
 both parties agreement was there. In the traditional times the people used to believe
 that the things that are of high prices are of very good quality where as in today’s
 time the quality is seen first and then the pricing. The customers needs are as kept
 in mind while making the product in the same way the pricing of the product are
 also kept by keeping in mind the customers and so different segments are been
 targeted for the different price and according to them the pricing are kept by the
 companies.

      The pricing along with the product also plays a significant role in attracting the
 customers and some times gaining competitive advantage also. A price if properly
 set with a quality product then it would tend the customers to purchase the product.
 As many times the customers are ready to pay a good amount of price for the
 product but with the expectation of providing quality products to them.

      The buyers force the sellers to reduce the prices of their product and that is the
 reason for which the discounting system has been emerged so that the buyers get
 due benefits of the price reduction and the manufacturers are also in advantage.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                METHOD OF SETTING PRICE BY
                 AARTI INDUSTRIES LIMITED:-
     The pricing in the AARTI INDUSTRIES LIMITED are set by the board of
 directors with the marketing managers.

     The companies also set their pricing in many of the ways. As in small
 companies the pricing is set by the boss. Whereas in the big industries the pricing
 policies, pricing objectives are set by the product or the department managers and
 later on it is approved by the top level management of the industries. Even in
 AARTI INDUSTRIES LIMITED the prices are firstly been set by the managers
 an then it is given to the top level management with the complete report with
 reasons of the set prices and after analyzing the whole report the top level
 management approves it (if the prices that are set are proper then the price is
 finalized and if not it is again reviewed and then by discussions the prices are set)

     And also in some industries where there are different department s like the
 finance department, marketing department, human resource department, production
 department, research and development, stores department health and safety
 department etc. the pricing is the key important area there is a separate pricing
 division which determines the appropriate price. And this pricing department
 reports to the marketing department, finance department and also the op level
 management.

     Previously companies used to think that pricing means profitability but now
 days with profitability it is getting more customers.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

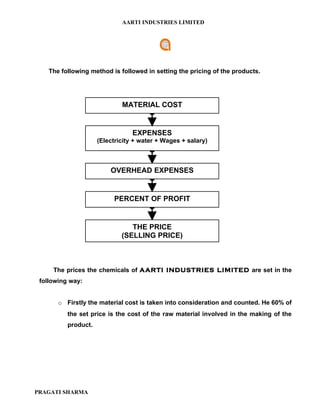

    The following method is followed in setting the pricing of the products.

                             MATERIAL COST

                                 EXPENSES
                     (Electricity + water + Wages + salary)

                         OVERHEAD EXPENSES

                          PERCENT OF PROFIT

                                THE PRICE
                             (SELLING PRICE)

     The prices the chemicals of AARTI INDUSTRIES LIMITED are set in the
 following way:

       o Firstly the material cost is taken into consideration and counted. He 60% of
          the set price is the cost of the raw material involved in the making of the
          product.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

       o Then the expenses are being calculated that is used or spent in the making
          of the product. These expenses are the electricity (power), water expense
          (pani) and the salary & wages (pagar) that are considered. These expenses
          involve 20% weightage.
       o After the expenses the overhead expenses are been considered. These
          overhead expenses may be the individual overhead cost. This expense has
          20 %of weightage.
       o Lastly the percentage of profit is been kept by the company.
       o Then finally the selling price of the products is been decided or finalized
          by the AIL.

     While AARTI INDUSTRIES LIMITED sets its price of a product at that
 time the company keeps in mind the following things:

       o Prices of that particular product for which the prices are to be set by the
          company, with the prices that are kept by the competitors of AIL
       o The quality of the product that are to be given to their customers. If the
          quality is very high than the prices are charged according to it by the AIL.

 PAYMENT PERIOD

     The payment period is as such not fixed by the AARTI INDUSTRIES
 LIMITED. Sometimes the company takes advance money from the parties
 (consumers). It depends upon the consumer/ customer if the customer is old and
 important then the maximum period for the payment given to them will be 15 days.
 There is as such no policy fixed or decided for the company for the payment.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

 PLACE:-

  DOMESTIC MARKET OF AIL

      AARTI INDUSTRIES LIMITED can be said as one of he largest producer
 of benzene based chemical product and intermediary chemicals in India and the
 products manufactured by the AARTI INDUSTRIES LIMITED are use in
 financial transactions without working with an agent or a broker. By using the
 internet, the most used media nowadays. The purchasing agents can search for the
 best vendors and also the values.

      Nowadays companies are trying to identify the customers who are more
 profitable to the company and most importantly who possesses values that are
 matching the company’s values in addition. This will help in developing quite a
 excellent amount of rapo between the company and its customers / consumers to
 carry out a long lasting relationship. As value helps in building relationships so
 does the service helps as it is the key point to be considered by the company as by
 providing the proper amount of service the company can win the heart of their
 customers.

      The companies are basing their decision on customer’s lifetime value rather
 than on intermediate profit maximization. Each company’s set up of belief and
 practice are under going challenges and change. These days all the business
 organization tries to do this type of marketing activities and they give main concern
 to marketing department because without the marketing tricks the organization will
 not exist.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

     The chemicals that are mostly sent in Indian markets are the

     1) benzene-based intermediates

     2) Sulphuric acid & its allied products.

     3) Agrochemicals & fertilizers

     4) Active pharmaceutical ingredients (apis)

     5) Other intermediates & speciality chemicals.

     The states in which the AARTI INDUSTRIES LIMITED markets its goods
 are as follows:

          Gujarat,

          Maharashtra,

          Hariyana

          Himachal Pradesh,

          Punjab.    And others

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

  EXPORTS OF THE AARTI INDUSTRIES LIMITED
     When the AARTI INDUSTRIES LIMITED realized the fact that the
 industry can cope up with their competitors and can also export their products in
 the foreign countries they begin exporting their products to the different countries.
 At that very time the AARTI INDUSTRIES LIMITED registered itself in the
 exports of Rs. 684 million which is equivalent to US $16.10 million. Over a year the
 company has registered a compounded average annual growth rate of more than 65
 per cent.

     Each year the AARTI INDUSTRIES LIMITED has seen a favorable rise in
 the volume of the exports. The quality then became the focus point of the company
 as soon as they realized their growth rate of the company in the foreign market.
 Superior quality and international standard generate an ever-rising demand for the
 company’s product in the foreign market. As the customers need more and more
 quality products so the company produced the products according to the needs of
 their customers. This was helping the company in holding a firm grip in the foreign
 export market.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

     This year the exports of AARTI INDUSTRIES LIMITED has increased
 from Rs. 255.04 crores to Rs. 341.61 crores (inclusive of export through trading
 house and relevant export benefits) registering the growth of 33.94%. The constant
 effort is being made to increase the exports.

     The AARTI INDUSTRIES LIMITED has been awarded “STAR EXPORTER
 AWARD” for the year 2004-05 by the “Gujarat Dyestuffs Manufacturers Association”
 for the highest foreign exchange from Direct Export of self Manufactured Dyes and
 Dyes Intermediates.

     AARTI’S exports are represented by way of the following chart.

     As we can see in the above graph that AARTI INDUSTRIES LIMITED is
 exporting most of its goods to Europe. It is because European countries have
 stopped the production of the chemical products in most of the parts of the country
 due to the environmental reasons. As even they need chemical in make of certain
 products and that the chemical production is banned in the country for this reason
 AARTI INDUSTRIES LIMITED is going for most or major export of its
 products in the European and the African countries.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

     The AARTI INDUSTRIES have associated with a subsidiary company,
 Alchemie Europe, in the UK, and have representation in the USA to provide better
 services to our overseas customers.

     ALCHEMIE EUREOPE LIMITED
     7-9, ST. MARY’S PALACE,
     BURY LANES, BL9 ODZ,
     ENGLAND.
     TEL: + 44-161-763-1624
     FAX: +44-161-763-1621

     Now AARTI INDUSTRIES LIMITED is inexorably working towards the
 setting up of the delivery points in their strategic location so as to cater its
 customer with all the quality products, services, comforts etc. by reaching to the
 customers and provide them with what ever they need and satisfy them in the
 shortest possible time to reduce the wastage of time and cost involved. The
 products that are to be exported to the different countries are as follows.

     Name of the products that are exported by the AIL. (These products are similar
 products that are marketed in India)

         •   Para Nitro Chloro Benzene (PNCB)
         •   Ortho Nitro Chloro Benzne (ONCB)
         •   2:4 Dinitro Chloro Benzene (DNCB)
         •   Para Dichloro Benzene (PDCB)
         •   Ortho Dichloro Benzene (ODCB)
         •   Nitro Benzene
         •   Alkylated Anilines & Toluidines
         •   Chloro Phenols
         •   Fluoro Compounds

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

         •   Agrochemicals

         •   Other Major Products
                o Bulk Drug Intermediates / Speciality Chemicals
                o Bulk Pharmaceuticals
                o Bulk Drugs under R & D
                o Dyes

     These are the above chemical products which are exported by the AIL to the
 different countries these countries are as follows:-

         •   United States of America,
         •   Germany,
         •   Italy,
         •   Belgium,
         •   Japan,
         •   United Kingdom,
         •   Spain,
         •   Switzerland and
         •   Korea.

     The AIL has set up its own Alchemic plant in United Stated of America and
 United Kingdom also so as to endow with better service to its North American and
 European Markets also that the manufactured goods is delivered to their customers
 on time and they do not have to linger too long for the delivery of the product and
 also the expenditure and time is not worn out.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

     With the increasing globalization and the trade among the countries, the
 company i.e. the AARTI INDUSTRIES LIMITED is well geared to make its way
 into the worlds market and establish its presence among them all.

 PROMOTION:
     The AARTI INDUSTRIES LIMITED has no promotion policy. The AARTI
  INDUSTRIES LIMITED does not go for any promotion of their chemical
  products. The AIL is a specialty chemical manufacturer so the consumers know
  that where and whom to contact directly. And the consumers directly contact the
  AIL. The advertisement is given just for the complement purpose not for the
  promotion purpose. Few ways of promotion done by the AARTI INDUSTRIES
  LIMITED is by the following ways.

           •   The AIL gives promotion in the business magazines. E.g. the
               publishing directory of VIA (Vapi Industrial Association). The
               complementary     advertisement    is   also   for   some   Educational
               Institutions if needed or necessary.
           •   The AIL gives the newspapers. If the newspaper people approach
               them personally asking for the advertisements then only the AIL
               gives the advertisement that too complementary

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

 PACKAING,   LABELLING,                           WARRANTIES                  AND
 GUARANTEES.

  PACKAGING
      The packaging is considered as the “fifth P” along with the product, price,
 place and promotion. How you present the product is felt to be of more importance.
 If a product has a good packaging then the customers would be attracted towards
 the product as sometimes the outer looks of the product also matters. As now days
 the world has become a show business if the thing you present is in a systematic
 and attractive way then it will be accepted with open hand and there is no doubt in
 this stanza.

      When we talk about the product packaging of the AARTI INDUSTRIES
 LIMITED, are of two forms they are

            •   Solid form (powder form) and
            •   Liquid form.

      So for both of these forms different kind of packaging is required. AARTI
 INDUSTRIES LIMITED does the packaging according to the need and the
 demand of the customers. The company manages to give the products (chemicals)
 the kind of packaging that matches the products characteristic and its adjustability
 with the plastic as most of the chemicals are packaged with the plastic. And if the
 chemical does not meet the characteristic of the plastic then the packaging material
 is coated with something else that can adjust the chemical concentration e.g.
 Tanker.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

      AIL is transporting its liquid chemical in the local market in the tankers. But if
 the tanker has the features and the characteristic that does not match with some
 chemicals so for that reason the company has come up with solutions that the
 tanker is coated with the glass inside so that the chemical concentration does not
 react with the tanker and cause any hazard.

      Solid form (powder form)

      In AARTI INDUSTRIES LIMITED the chemicals are also in the solid form
 which is then converted in the small crystals like sugar for the customers. These
 solid crystals are mostly packaged in the white plastic gunny bags. These bags are
 for the local market as well as for the export purpose also. The plastic gunny bags
 minimum size is 50 kg and this is mostly used for the local market packaging and
 the demand of the customers.

      For the export purpose he plastic gunny bags are only used but the size of the
 gunny bag differs. The size turns to be 500 kg when it is sent to the foreign
 customers. This bag has such characteristic which matches the chemicals that are
 filled in the bags.

      Liquid form

      In AARTI INDUSTRIES LIMITED the liquid chemicals are mostly sent in
 big containers. These containers are packed in such a way that the chemical does
 not react with the drums. These drums are of different sizes and he drums are made

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

 of such material which can bear the highly chemical characteristic so that there is
 no hazard caused and the chemical reaches the customers safely.

     Even the drums might be of that characteristic which does not match the
 characteristic of the chemical so in that case the drums are covered with the metal
 of construction according to the physical characteristic of the chemical. So the
 plastic containers are coated inside it with the material which does not react with
 the chemicals.   The transport people keep it when the truck-tanker is used for
 sending the chemicals in the local market.

     LABELING
       The labeling is done by the company in a most simplest and understandable
 way. As the labeling is simple the workers also understand it properly and so the
 chances of damage of any hazard is reduced and the danger is reduced.

     Format of the labeling that is done on the gunny bags which are sent to the
 customers by the company. The format of labeling of the domestic and the foreign
 market that are on the gunny bags are the same with few more additions done in the
 foreign bags format.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                     PARA NITRO CHLORO BENZENE

             LOT NO: _____________________________________________

             GROSS WEIGHT: _____________________________________

             TARE WEIGHT: ______________________________________

             NET WEIGHT: ________________________________________

             BAG NO: ______________________________________________

                       AARTI INDUSTRIES LIMITED

                                MADE IN INDIA

                               USE NO HOOKS

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

     In AARTI INDUSTRIES LIMITED the labeling which is done on the gunny
 bags are also done on the drums in which the liquid chemical is being filled or
 sending it to the customers.

                        NAME OF THE CHEMICAL

                 LOT NO: ____________________

                 GROSS WEIGHT: ____________

                 TARE WEIGHT: _____________

                 NET WEIGHT: _______________

                 BAG NO: ____________________

                        AARTI INDUSTRIES LIMITED

                                   MADE IN INDIA

                              HIGHLY POISONOUS

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

     The above diagram is of the drum for the liquid chemical where in such
 information are written such as:

    The lot number:

      The lot number is there which means that the drum is containing the chemical
 whose lot number is suppose 56 so that if there is any problem in the chemical than
 the lot number will help in knowing that whether the whole lot is spoiled or only that
 particular drum is spoiled.

    Gross weight:

     Gross weight means the weight of the chemical, whether in solid or liquid
 forms that is kept in the gunny bags or the drums.

    Tare weight:

     Tare weight is the weight of the gunny bag or the drum in which the chemical is
 being filled for transportation.

    Net weight:

     Net weight is the sum of the gross weight and the tare weight.

    Bag number:

      The bag number is given to each and every bag. If the lot of the chemical is
 spoiled then for knowing that in a particular lot which bag is spoiled and easy to see
 that whether the whole lot is spoiled or only that particular bag or drum is spoiled

 WARRENTIES & GUARANTEES:

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

      As AARTI INDUSTRIES LIMITED is a chemical producing company they do not
 give any warranties and the guarantees as the chemicals of AIL are of the finest
 quality produced and offered to the customers.

           THE DISTRIBUTION CHANNEL OF AIL
     The distribution channel of AARTI INDUSTRIES LIMITED is very short and
 simple. The VAPI plant manufactures the product. The marketing department
 MUMBAI gives the order that they have receive to the VAPI branch. The VAPI
 branch then sends the product i.e. the chemicals to the customers as per the orders
 given by the marketing department MUMBAI about the customers who have given
 orders and are located in the different parts of the country.

                          MANUFACTURER

                                                        SALES MENS

                 CUSTOMERS

     The AARTI INDUSTRIES LIMITED make the chemical which are specialty
 manufactured so there is no third party the customers directly contact AARTI
 INDUSTRIES LIMITED. The distribution channel of AIL also consist of the sales
 man’s who move on to the different parts of the country and they give samples of
 their product to the companies and the companies they use those products
 (chemical) and observe that the product is having all the things which they want

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

 also with excellent quality and if they get it, they do purchase the products. There is
 no third party, agent or any distributors of the company.

                 MODE OF TRANSPORTATION

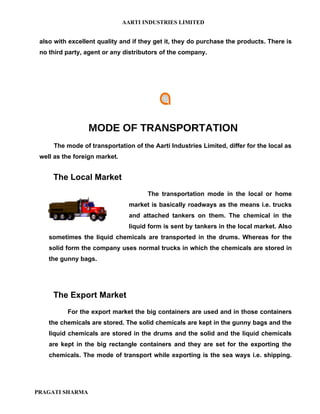

     The mode of transportation of the Aarti Industries Limited, differ for the local as
 well as the foreign market.

     The Local Market
                                      The transportation mode in the local or home
                                market is basically roadways as the means i.e. trucks
                                and attached tankers on them. The chemical in the
                                liquid form is sent by tankers in the local market. Also
    sometimes the liquid chemicals are transported in the drums. Whereas for the
    solid form the company uses normal trucks in which the chemicals are stored in
    the gunny bags.

     The Export Market
          For the export market the big containers are used and in those containers
    the chemicals are stored. The solid chemicals are kept in the gunny bags and the
    liquid chemicals are stored in the drums and the solid and the liquid chemicals
    are kept in the big rectangle containers and they are set for the exporting the
    chemicals. The mode of transport while exporting is the sea ways i.e. shipping.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

   The chemicals from the company move on in a truck till the dock and from the
   dock it is shipped.

                                                   Gunny
                                                    Bags

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                 DISPATCH DEPARTMENT

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

     The AARTI CHEMICALS have a systematic dispatch department.               The total
 numbers of people working in the department are 8 and all are in the same post. The
 marketing department MUMBAI gives the order to the dispatch department VAPI.

     The channel flow of the Dispatch Department.

                        MUMBAI OFFICE

                                           The Mumbai office gives the order to the
                                           Dispatch department Vapi.
                   DISPATCH DEPARTMENT

                          PRODUCTION
                          DEPARTMENT

                   DISPATCH DEPARTMENT

     The Mumbai office gives the order to the dispatch department which is in Vapi.
 The dispatch department then confirms the production department whether they
 have the products already made in the stocks or not.

     If the product is ready (produced previously and kept) then the dispatch
 department takes the ready products from the department and directly dispatches
 the products i.e. chemicals on the very same day is sent. The dispatch department

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

 gives the order which is to be sent to the customers, to the production department
 so that the chemicals are produced before 5 days of the date of dispatching the
 order so that there is no delay in the sending of the order and that the company’s
 reputation of delivering the products on time is saved and maintained.

     Such are the containers which are used for the export purpose these
 containers contain the drums in such a way there is no space left and the drums in
 the containers cannot move accidents are so the chances of accidents are reduced.
 The same is in the case of the gunny bags.

     When the product is sent to the customers for the delivery at that time the
 company i.e. the dispatch department gives the truck driver a memo. In that memo
 there are some information’s which are to be feeded by the company as well as the
 customers to which the product is been sent for the delivery purpose.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

     The memo consists of the information’s such as:

         •   The date of delivery.
         •   The customers name and address, (To whom the product is being
             delivered)
         •   What the product is?
         •   The quantity of the product.
         •   Memo number.
         •   Number of the truck on which the product is sent.
         •   The sign of the person who has taken the product.
         •   Sign of the person who has received the product.

     These information’s help when there is any problem or misunderstanding that
 has arise due to anything for that purpose he company keeps an account of such
 kind of information’s. The memo which is sent has minimum 4 copies. These copies
 are issued by the company itself and for the people like:

         •   The main copy for the company itself
         •   Other copy for the customer
         •   Other for the tax and excise department and
         •   Office use i.e. dispatch department.
                               (As per the company’s rule)

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                     PRODUCTION DEPARTMENT

  MANUFACTURING FACILITIES

     AARTI has two API manufacturing plants located at Dombivli and Tarapur in
 Maharashtra with total area of about 15000 sq mts, and a reactor volume of more
 than 70 M3. The production facility at Dombivli has been designed to meet WHO
 GMP standards and Tarapur facility to be commissioned in January of 2005 will be
 US FDA compliant.

     AARTI INDUSTRIES plants have Stainless Steel and Glass-lined Reactors
 ranging from 50L to 3000L capacity. The finishing areas have appropriate air
 handling system with terminal filters as required. The process water is designed to
 meet USP requirements. Our plant facilities are equipped with multi-mills,
 micromeshes etc. that provide products with particle size and bulk density as
 required by customers.

  ANTI-HYPERTENSIVE

          CILAZAPRIL

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

          MOEXIPRIL
          ISRADIPINE

   ANTI-PARKINSONIAN

          PRAMIPEXOLE
          ROPINIROLE
          ENTACAPONE

   ANTI-ASTHMATIC

          MOMETASONE

   ANTI-ACNE

          ADAPALENE

MACHINE AND EQUIPMENTS

The following are the machine and equipments which are used in the AIL:

          Storage tanks
          Reactors vessel
          Distillation columns
          Condensers
          Pumps
          Absorber
          Scrubber
          Boiler

     Boiler is equipment in which steam is produced from water in an economical
 way i.e. by using cheap but high calorific value fuel.

      Steam is required in most of the chemical manufacturing processes.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

 Types of Boiler:

      Depending upon the type of fuel used for steam generation the boilers are
 divided into different types.

          Coal fired boiler
          Oil fired boiler
          Agro waste fired boiler

      In AIL the steam of 24 kg/cm^2 is generated from oil and coal fired boiler. There
 are two (18 and 13TPH) coal fired boiler and one (10 TPH) oil fired boiler.

                         PLANT LAYOUT
 Layout:-
     Layout refers to the systematic arrangement of facilities in a particular work.

                                     As plant layout is an overall arrangement of the
                               production process. Store room, stock room, material
                               handling equipment, employee services & all other
                               accessories required for facilitating the production in
                               the factory. It is a Master Blue Print for co-
                               coordinating all operation performed inside the
                               factory. The same is we will see of he AARTI
                               INDUSTRIES           LIMITED.         How       AARTI
                               INDUSTRIES has managed to arrange the layout of
                               their company and their company’s layout has helped
                               them to make their work very efficient while doing.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

 OBJECTIVES OF PLANT LAYOUT

             To minimize handling and transportation of material
             To ensure economic utilization of available floor space.
             To ensure efficient control over the various processes of production.
             To minimize cost of production.
             To maximize convenience and safety of the workers.

                                 PLANT LAYOUT

   SSP                    Back Security
                                                                Fire
                                                              Fighting
  Boiler
                                                               Pump          Water
                           ACID PLANT                          House        Reservoir
  DMS                       SECTION
  Plant                                                       Ammonia
                                                               Storage
                             3.4 DCNB        PNCB               Tank
                             Distillation    Flaking
            ETP
                              Section        Section

           HCL Storage                            2, 5-        3, 4-        OPDA
                                  Safety         DCNB         DCNB          Plant
                                  Dept.
           MCB Plant                                    95% PNCB
                                   DG                  Crystallization
                                 Section           CN    Crystallizatio     Distillation
           Acid Storage                          Section  n Section          Section
          MCB                       Acid
         Storage
PRAGATI SHARMA                     Storage
          Tanks                                                 NCB Plant
AARTI INDUSTRIES LIMITED

                                 Canteen Administratio        Inst.    Liq. PNCB
                                           n Bldg.            Secti     Storage
                                                               on

                                                  OHC

                                                   Car                Garden
                                 Security         Parkin
                                                    g
      Bicycle
      Parking

                                 GIDC ROAD

 Types of plant layout

 Mainly there are few types of layout that are given below.
        Process layout
        Product layout
        Fixed Position layout
        Combined layout

     In AARTI INDUSTRY the company follows a combined layout. The combined
 layout is relevance of the product layout, process layout or fixed location layout and
 their firm meaning is difficult to know. As in the most of the industries and the
 companies the combination of the product layout and process layout is noticed. It is
 possible to have both types of layout in an efficiently combined form.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

     As AARTI INDUSTRY is producing chemical product, they are applying
 combination of both product layout and process layout because the machineries
 from which they are producing chemical are arranged in accordance to their product
 and the way it is to be processed.

                     MATERIAL HANDELING SYSTEM
     It involves the movement of material from one place to another for the purpose
 of processing. The material handling equipments are as follows
               Cranes
               Industrial trucks
               Pipe lines.
               Pallet.
               Fork lifts truck.

                           PRODUCTION PROCESS
 Raw material

     The company manufacture its products from the basic raw material-benzene
 and sulphuric. The other major raw materials are chlorine nitric acid, ammonia,
 caustic soda, and methanol. All these raw material are available freely in sufficient
 quantity in the local and international markets. The major suppliers of this raw
 material are:-

       •       Reliance industries ltd.
       •       Bharat petroleum corporation ltd.
       •       National organic chemical Industries ltd.
       •       Standard albalies ltd.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

      •   National rayon corporation ltd.
      •   Grasim industries.
      •   Gujarat Narmada Valley Industries corporation.
      •   Deepak Nitrate ltd.
      •   Transport ltd Dubai.
      •   Helm chemicals Germany
      •   Universal chemical Bahrain.

    Raw material                             Purity

    Mono chlorobenzene                                99.99%
    Nitric acid                                       98%
    Sulphuric acid                                    98%
    Spent Acid                                        72%
    (Part of sulphuric acid)

 PRODUCTION PROCESS:

 NITRATOR            SEPARATOR              WASHER             SEPARATOR

                                            SPENT                          WATER
                                             ACID               NCB
   MCB,
 MIX ACID,              STORAGE
NITRIC ACID               TANK
                                                               DRYER        ETP

                                 P CUT

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

 DISTILLATION              CRYSTALLIZATION                 STORAGE TANK
                                                               NCB

                    ML

     PURE                         PURE
     ONCB                         PNCB

     PRODUCTION PROCESS:
                                       Raw material like monochloro benzene, nitric
                                  acid, Sulphuric acid, spent acid (part of Sulphuric
                                  acid) are brought in the plant and before they get
                                  into further process there is tight quality check on
                                  it, it eh material is in proper form then it is sent to
                                  the plant for further proper form then it is sent to
                                  the plant for further processing.

     In the plant the raw materials are brought together in a nitrator, in the nitrator
 mono chloro benzene is then mixed acid and nitric acid. Then this mixture is further
 sent to the separator through pipes as it is in liquid form. Through separator NCB is
 obtained which floats above spent acid sediment down. The NCB is now sent to

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

 washer and spent acid is sent to storage tank. The washer machine is filled with
 water in which NCB is washer and separated.

     From this the water is sent to ETP. NCB is sent to dryer machine for drying the
 remaining water. From dryer machine NCB is sent to storage tank. NCB is now ready
 for crystallization process. Through crystallization process pure PNCB is obtained.
 ML is also obtained which is sent for distillation process. Through this pure ONCB
 is obtained. P-cut is also obtained which is again sent for crystallization process.

     From the above process NCB, PNCB, ONCB are obtained. These are in liquid
 form when produced. According to customer’s preference they are converted into
 flake form or powder form as a required.

 Acid section
      In turbine there is Sulphate acid which is pumped with dry air latter it is burning
 up to 90 c along with putting SO2 it then moved to WHB and putting water in it and it
 is converted in to 420c and go in the form of stem to the converter 1 bed. After this
 process we get SO3. Remaining portion is moving in to SH for the purpose of
 heating and it shift to converter 2nd bed and finally moved into HHE for the purpose
 of making cooling and some potion Goggles back to HHE and remaining portion
 shifted into SO3 generator 1st and 2nd. Then it is moving into OT 1st and 2nd for the
 purpose of mixing and during this process we get some portion of 23% and
 remaining portion shifted into absorption tower and during this process some
 portion is go back to CHE. In absorption tower sufficient arrangement so that 98%
 H2sO4. We can procure and it shifted into converter 4th bed. In this converter some
 portion of H2so4 coming from HHE and further it moved into economizer and we get
 finish product SO3 and remain portion in the form of gas moved into final

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

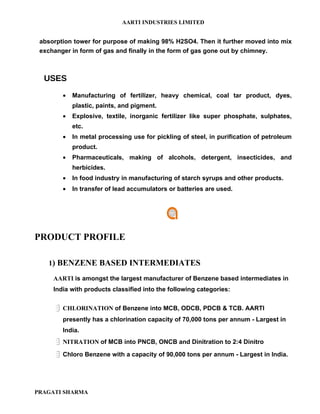

 absorption tower for purpose of making 98% H2SO4. Then it further moved into mix
 exchanger in form of gas and finally in the form of gas gone out by chimney.

  USES
        •   Manufacturing of fertilizer, heavy chemical, coal tar product, dyes,
            plastic, paints, and pigment.
        •   Explosive, textile, inorganic fertilizer like super phosphate, sulphates,
            etc.
        •   In metal processing use for pickling of steel, in purification of petroleum
            product.
        •   Pharmaceuticals, making of alcohols, detergent, insecticides, and
            herbicides.
        •   In food industry in manufacturing of starch syrups and other products.
        •   In transfer of lead accumulators or batteries are used.

PRODUCT PROFILE

   1) BENZENE BASED INTERMEDIATES

     AARTI is amongst the largest manufacturer of Benzene based intermediates in
     India with products classified into the following categories:

      CHLORINATION of Benzene into MCB, ODCB, PDCB & TCB. AARTI
        presently has a chlorination capacity of 70,000 tons per annum - Largest in
        India.

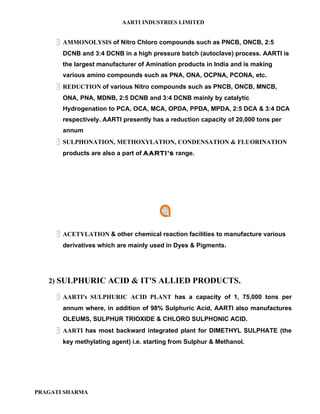

      NITRATION of MCB into PNCB, ONCB and Dinitration to 2:4 Dinitro
      Chloro Benzene with a capacity of 90,000 tons per annum - Largest in India.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

     AMMONOLYSIS of Nitro Chloro compounds such as PNCB, ONCB, 2:5
       DCNB and 3:4 DCNB in a high pressure batch (autoclave) process. AARTI is
       the largest manufacturer of Amination products in India and is making
       various amino compounds such as PNA, ONA, OCPNA, PCONA, etc.
     REDUCTION of various Nitro compounds such as PNCB, ONCB, MNCB,
       ONA, PNA, MDNB, 2:5 DCNB and 3:4 DCNB mainly by catalytic
       Hydrogenation to PCA, OCA, MCA, OPDA, PPDA, MPDA, 2:5 DCA & 3:4 DCA
       respectively. AARTI presently has a reduction capacity of 20,000 tons per
       annum
     SULPHONATION, METHOXYLATION, CONDENSATION & FLUORINATION
       products are also a part of AARTI's range.

     ACETYLATION & other chemical reaction facilities to manufacture various
       derivatives which are mainly used in Dyes & Pigments.

   2) SULPHURIC ACID & IT'S ALLIED PRODUCTS.

     AARTI's    SULPHURIC ACID PLANT has a capacity of 1, 75,000 tons per
       annum where, in addition of 98% Sulphuric Acid, AARTI also manufactures
       OLEUMS, SULPHUR TRIOXIDE & CHLORO SULPHONIC ACID.
     AARTI has    most backward integrated plant for DIMETHYL SULPHATE (the
       key methylating agent) i.e. starting from Sulphur & Methanol.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

   3) BULK PHARMACEUTICALS:

     AARTI is making various Bulk Pharmaceuticals in the range of Antidiarrhoeals,
  Antiinflammatory, Vitamins, Antiasthama, Anti HIV, Antijetlag / Sleep Disorder, Ace
  Inhibitor, Antibiotics & Antidiabetics.

   4) AGROCHEMICALS:

     These comprise of Quinalphos & Carbendazim.

   5) DYES:

      AARTI has started getting dyes manufactured on contract basis from the
        local manufacturers exclusively for exports.
      The AIL have a well equipped quality control laboratory at MUMBAI with
        sophisticated equipments like:
               o Gas Chromatography Machine, UV/LR Spectrophotometer,
                  Potentiometric Titration equipments, HPTLC, High Pressure Rotta
                  Dyer.
               o We are now able to supply chromium free dyes in powder & liquid
                  form for Swimming Pool & Spa applications.
               o We supply liquid dyes in Eco friendly packing of IBC Tunner &

                  powder in biodegradable corrugated boxes.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

   6) OTHER INTERMEDIATES & SPECIALITY CHEMICALS:

         Alkylated Amines and toluidiness,
         Chlorophenols,
         Fluoro Compounds,
         Other specialty chemicals.

  ORTHO NITRO CHLORO BENZENE
  Product Details

                                     2- Chloro Nitro Benzene (Ortho Nitro Chloro
   Chemical Name
                                     Benzene) (88-73-3)

   Chemical Formula                  C6H4NO2CL

   Molecular Formula

   CAS No.                           88-73-3

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

   Molecular Weight              157.5
   Appearence                    LIGHT YELLOW LIQUID
   Moisture                      1000 PPM MAX.
   Set point                     31.7°C MIN
   Purity by GC                  99.65 % Min.

                                 DYESTUFF       &       DYESTUFF
                                 INTERMEDIATES
   End Use                       PHARMA & PHARMA INTERMEDIATES
                                 AGROCHEMICAL      INTERMEDIATES
                                 SPECIALITY CHEMICALS

    DINITRO CHLORO BENZENE
    Product Details

   Chemical Name            2,4 Dinitro Chloro Benzene (97-00-7)
   Chemical Formula         C6H3(NO2)2Cl

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

   Molecular Formula

   CAS No.                   97-00-7
   Molecular Weight          202.5
   Appearence                Pale Yellow to Reddish
   PH                        6.5 to 8.0
   Typical impuriy           Insolubles: 0.2 % Max.
   Moisture                  0.2 % Max.
   Set point                 48.5 oC to 49.5 oC
   Purity by GC              99.0 % Min.

   End Use
                             DYESTUFF & DYESTUFF INTERMEDIATES

     PARA DICHLORO BENZENE
     Product Details

                            1,4 Dichloro Benzene (Para Dichloro Benzene)
   Chemical Name
                            (106-46-7)

   Chemical Formula         C6H4Cl2

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

   Molecular Formula

   CAS No.                  106-46-7

   Molecular Weight         147

   Appearence               Colourless liquid

   Moisture                 1000 ppm Max.

   Set point                52.5 °C MIN

   Purity by GC             99.75 % Min.

   End Use                  DYESTUFF & DYESTUFF INTERMEDIATES
                            PHARMA & PHARMA

     ORTHO DICHLORO BENZENE
     Product details

                             1,2 Dichloro Benzene (Ortho Dichloro Benzene)
   Chemical Name
                              (95-50-1)
   Chemical Formula          C6H4Cl2

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

   Molecular Formula

   CAS No.                   95-50-1
   Molecular Weight          147
   Appearence                Colourless liquid
   Purity by GC              99.75 % Min.

                             DYESTUFF & DYESTUFF
   End Use                   INTERMEDIATES AGROCHEMICAL
                             INTERMEDIATES SPECIALITY
                             CHEMICALS

     NITRO BENZEN
     Product details

   Chemical Name             Nitro Benzene (98-95-3)
   Chemical Formula          C6H5NO2

   Molecular Formula

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

   CAS No.                     98-95-3
   Specification               IBP : 208 oC to 210 oC
   Molecular Weight            123.11
   Appearence                  Colourless liquid in Aniline
   Melting Point               5.2 oC
   Boiling Point               210 oC to 211 oC
                               DNB content : 0.02 % to 0.03 % Max.,Others :
   Typical impuriy
                               0.67 % to 0.68 %
   Form and Net Weight         Tanker load
   End Use                     DYESTUFF & DYESTUFF INTERMEDIATES
                               AGROCHEMICAL INTERMEDIATES
   Product Details
   Chemical Name               4-Chloro Phenol (PCP)
   Chemical Formula            C6H5ClO

   Molecular Formula

   CAS No.                     106-48-9
   Molecular Weight            128.5
   Appearence                  White Yellowish crystalline / fused
   Odour                       Phenolic odour
                               Di Chloro Phenol, Phenol,2-Chloro Phenol &
   Typical impuriy
                               Others :Less than 1 %
   Form and Net Weight         250 kgs. : M.S. Drums
                               DYESTUFF & DYESTUFF INTERMEDIATES
   End Use                     AGROCHEMICAL INTERMEDIATES
                               SPECIALITY CHEMICALS

   PARA NITRO CHLORO BENZENE
   Product Detail

    Chemical Name                    4 - Chloro Nitro Benzene (Para Nitro
                                     Chloro Benzene) (100-00-5)
    Chemical Formula                 C6H4ClNO2

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

    Molecular Formula

    CAS No.                        100-00-5.

    Molecular Weight               157.5

    Appearance                     Light yellow to yellow flakes

    Typical impuriy                ONCB:0.50% MAX

                                   1000 ppm Max.(Flakes) & 1500 ppm
    Moisture                       Max (Liquid)
    Set point                      82.2 °C Min. (Flakes) & 81.0 °C (Liquid)

    Purity by GC                   99.50% Min.
    Packaging                      250 kg Steel Drum / 18 MT FCL

                                   DYESTUFF     &     DYESTUFF
                                   INTERMEDIATES   PHARMA    &
    End Use                        PHARMA        INTERMEDIATES
                                   PIGMENT       INTERMEDIATES
                                   AGROCHEMICAL INTERMEDIATES

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

QUALITY CONTROL AND RESEARCH & DEVELOPMENT

                             Quality:-
                                  Quality is the totality of the features and the
                             characteristics of a product or services that bear on its
                             ability to satisfy the stated or implied needs of the
                             customer. Quality is the sum of the attributes that
                             describes the product. According to the AIL, the
 objectives of quality are listed below.

     Being a chemical company, consumers may not be directly using AIL's
 products, and it may be difficult to see how the chemicals they produce enrich the
 lives of people. But the AIL do contribute towards improving the people’s quality of
 life since the end users of our products are industries ranging from agrochemicals
 and dyes to speciality chemicals and pharmaceuticals - markets that are critical to
 long-term sustainability. By supplying high quality and good value products to our

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

 customers, we indirectly help people to have access to better medicines, fertilizers
 and diverse items of daily use. In other words, greening the supply chain
 management plays a significant role in our business strategy.

 Objective of Quality

     AARTI INDUSTRIES is expert in producing (chemicals) a product with a
 world class quality. As for AIL their customers play a significant role in their
 development in the same way for their customers the quality plays a significant role
 so the AIL observes that their product is of the most excellent quality and that their
 customers are greatest satisfied with the quality of their product (chemicals).

     The objectives of AIL are as follows.

        To satisfy the consumer.
        To reduce the cost.
        To improve the income.
        To increase the productivity.

     AARTI      INDUSTRIES         LIMITED      has proficiency in developing or
 innovating new products & processes that have world class quality. AARTI
 INDUSTRIES LIMITED carries on research in various areas and that too with a
 special   emphasis    on    pharmaceutical    intermediates,    Agro    intermediates,
 pharmaceuticals, Agrochemicals & specialty chemicals.

 QUALITY POLICY

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

     Good health cannot be achieved without quality products and quality
 manufacturing facilities. We meet all the pharmacopoeias requirements, industry
 standards and laws that govern manufacture of APIs & Intermediates. Our Research
 facilities and plants are designed to meet world-class standards. Our processes are
 will established and have properly documented quality management systems as per
 c-GMP guidelines. Our Quality Assurance ensures quality requirements, systems
 and procedures to meet c-GMP norms.

     A periodic training facility to people ensures compliance of GMP needs.

 QUALITY CONTROL

     The products quality is influenced at various stages of design, production,
 storage, sale, use etc and as design is not in consideration in the AARTI
 INDUSTRIES so for them this is excluded from the rest and the rest should be
 considered very carefully. For quality control the AARTI INDUSTRIES are checking
 the quality of the product in the following ways.

      The      AARTI INDUSTRIES LIMITED checks the quality of the raw-
         material before receiving that raw-material from their suppliers.

      The      AARTI INDUSTRIES LIMITED verifies the raw-material received
         from their suppliers in the laboratory whether that material is of quality or
         not.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

      The   AARTI INDUSTRIES LIMITED also inspects the quality of the
         product in between of the production process to confirm the quality of the
         product.

      The AARTI        INDUSTRIES LIMITED examines the product’s quality at
         the end of the production process to ensure the best quality of their product
         (chemicals).

     Thus in this way the AARTI INDUSTRIES LIMITED is controlling the
 quality of their product. They are examining that whether the quality of their product
 is meeting the customer’s essential criteria and needs or not.

 QUALITY MANAGEMENT SYSTEMS:-
 AARTI INDUSTRIES LIMITED is and ISO 9001-2000.

     Quality assurance:
     The AIL is a company which is able to provide a mass goods of uniform
 quality. AIL also follows the quality policy according to which it had obtained
 ISO-9001, 2000 version certificate (obtained from TUV).

     Quality policy:-
     AIL leading manufacturer of intermediates and specialty chemicals is
 committed to provide quality products and services leading to total customer
 satisfaction while conducting business. We shall strive to continually improve

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

 performance, process and system with and aim to be world class in terms of
 productivity, safety, occupational health and environmental performance by
 harnessing the competence of employees and ensuring their involvement.

     Tools used to maintain the quality:
           AIL is using various tools to control the quality standards. These are

           HPLC: High pressure liquid chromatography
           GLC: Gas liquid chromatography
           DCS: Digital Control System scrapin

     AARTI INDUSTRIES LIMITED has an expertise in developing or
  innovating new products and processes that have world-class quality. AARTI
  INDUSTRIES LIMITED is doing Research in their own unit, in various areas
  with special emphasis on Pharmaceutical Intermediates, Agro Intermediates,
  Pharmaceuticals, Agrochemicals and Specialty Chemicals.

     AARTI INDUSTRIES LIMITED has fully equipped laboratory with high-
  tech advanced instruments and highly qualified technical personnel at their R & D
  centers. AARTI’s advanced Analytical Instruments includes the following:

    Gas Chromatograph & HPLC           Digital Polarimeter
    Auto Titrator                      Digital Melting Point Instrument
    UV Visible Spectrophotometer       FTIR Spectrophotometer

     AARTI at its Pilot Plant facility has R & D Process Equipments like:

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

        Glass Reaction Equipment                 Glass Lined Reactors
         High Pressure Autoclave                    SS 316 Reactors
          Distillation Equipment                      Centrifuges
              Sparkler Filter                    Air Handling Systems

     AARTI's pharmaceutical plants are GMP (goods manufacturing practices)
 approved and some of the plants have got ISO 9002 Certification also.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                 RESEARCH & DEVELOPMENT
     AARTI INUSTRIES LIMITED has fully equipped laboratory with high-tech
 advanced instruments & highly qualified technical personnel at its R&D centers that
 help the AIL to make the product which is of the paramount quality which also
 helps the AIL to cater the number of customers for themselves with the maximum
 number of the market share and place the AARTI INDUSTRIES LIMITED
 among the top most chemical manufacturing products in the world.

     The AARTI INDUSTRIES LIMITED has four state-of-the-art R & D
 centers, recognized by DSIR (Dept. of Scientific & Industrial Research), Government
 of India, which carry out innovative product and process development work with
 special emphasis on pharmaceuticals and speciality chemicals.

 The advanced Analytical instruments of AARTI INDUSTRIES LIMITED
 include:

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

       Centrifuges
       Gas chromatograph & HPLC
       Distillation equipment
       4Digital Polarimeter
       Glass Reaction equipment
       Sparkler filter
       Air handling system
       Auto Titrator
       FTIR spectrophotometer
       Glasslined Reactors
       Uv visible spectrophotometer
       High pressure Auticlave
       Digital melting point instrument

      AARTI`s pharmaceutical plant are GMP approved & some of the plants have
 got ISO 9002 certificate.

   •   Areas in which R&D carried out by the company:

       The R&D activities are carried out by the company in the areas of

         Bulk and pharmaceuticals formulations,
         Specialty chemicals and
         Intermediate chemicals.

   •   Advantage from R&D:

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

            The R&D centers of AARTI INDUSTRIES LIMITED at Vapi are
       showing satisfactory progress in their development of new products and
       improvement in existing product efficiencies.

   • Future plan of action:

              The AARTI INDUSTRIES LIMITED will maintain its R&D activities
       and the innovation and development of new products and improvements in
       existing product efficiencies.

   •    The company has incurred the following expenditure in research and
        development. In the areas of new products and improvement in existing
        products efficiencies.

         Expenditure on R&D                              (Rs. In lakhs)
            • Capital                                    131.91
            • Recurring                                  56.51
            • Total                                      188.42
            • Total R&D expenditure as a percentage of
              total turn over -0.27%

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                    STORES DEPARTMENT 
 Engineering goods
  Small parts

 In alphabetical order
  Given the code to each part

  LIFO method for engineering goods.

 Raw material of the chemicals
   Chlorine
   Nitric acid
   Benzene
   Methane

 Controlling of waste:
      Resale in the market
      As a fertilizer

           NCB

           MCB

           PNCB

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

            ONCB Refinery process

      COMPONENTS IN THE ENGINEERING STORE

  •   Nut and Bolt                         •   Hose Nipple
  •   V belt                               •   Hex Nipple
  •   Gland Thread Pump                    •   Flange
  •   Copper Tube                          •   Needle Valve
  •   Impeller Pump                        •   Ss Valve short/long
  •   Compressor                           •   Blend
  •   Stainless Steel Pipe                 •   Steam Trap IVR
  •   Float Valve                          •   Shed Glass
  •   Siphon Tube                          •   Cf bag
  •   Metallic Hose Pipe                   •   Filter Bag
  •   Compressor                           •   Joining Gasket
  •   Oil seal for gear box in Reactor     •   Rex Rubber PVC
  •   Star butch                           •   Bush Bolt Sheet
  •   Pulley                               •   Chalk
  •   Gear Box                             •   Cotton Mask
  •   Motor Reactor                        •   Spoon
  •   Coupler                              •   Disposable cap/Gloves
  •   Teflon Gasket                        •   Muff Ear Mask
  •   SPO Pump                             •   Teflon Tape
  •   Motor                                •   Gumboots
  •   Valve                                •   Goggles
  •   HDP Fitting                          •   Rubber/PVC Hand
  •   Butterfly Valve                      •   Gloves
  •   Esteem Valve NRV                     •   Wire Brush
  •   Tool kit                             •   Pump Spares
  •   Welding Rod                          •   Ball Bearing
  •   Pressure Gauge                       •   Vacuum
  •   Water Line                           •   Boiler/Electrical Spares

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

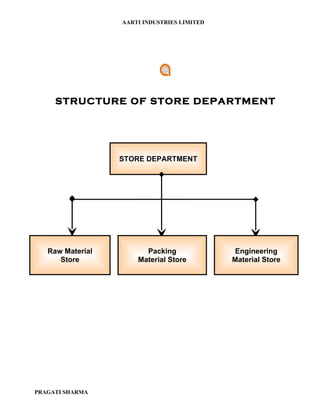

     STRUCTURE OF STORE DEPARTMENT

                  STORE DEPARTMENT

   Raw Material         Packing              Engineering
      Store           Material Store         Material Store

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

   FLOW DIAGRAM OF RECIEPT OF STORE
              MATERIAL

                         Receipt of material and inward entry

                               PREPARATION OF RMR

             Stacking at under Physical inspection by Expert’s Person

             Getting Quality report in terms of approved or rejected

          Unloading of material in proper pattern at unloading point
                   and verification with vendors challan

                  Rejected material are returned to concerned vendors

                 Approved material are kept in proper stacking for
                      consumption as per daily requirement

                                                  GRR prepared
PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

         OPERETION PROCESS OF STORE
                DEPARTMENT

        VENDORS                                               PURCHASE

                                    Purchase
                                     Order                               Purchase
            Material                                                    Requisition

                                 STORE DEPARTMENT

                                                      Issue of material to plant

               EXCISE

                        Modvat
                                                                    GRN

                                 ACCOUNT DEPARTMENT

          Invoice

                                                         Payment

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

    FLOW DIAGRAM FOR GENERATION OF
     REQUIREMENT OF STORE MATERIAL

                  Monthly Requirement of store
                      material by the user

                     Generation of purchase
                          requisition

                  Release of purchase order by
                    the purchase department

                      Verification of released
                    purchase orders by store in
                 terms of monthly requirement of
                         user department

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                   PLANT UTILITY DEPARTMENT
      Every plant or industry or human being requires certain basic necessities
 without which it would be impossible to function. Necessities like water, air, energy
 (power) etc are just these and fall under the category called utilities. It is no wonder
 that the utility section is called the heart of the plant.

     At AARTI INDUSTRIES LIMITED, the following utilities are created and
 consumed such that various other plants producing various products are the major
 consumer of this utility. These utilities are mainly:

          STEAM

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                 High pressure
                 Low pressure
                 Medium pressure

          AIR
                 Process air
                 Instrumentation air
          RAW WATER

          POWER

          CHILLING WATER
                 Brine water
     Steam
     This basic utility is created in bulk at Sulphuric acid plant and Boilers.
 Advantage of steam

                o Easily available
                o Relatively cheap to make
                o Provide a good heat transfer medium

     Air
      A very important utility for any plant, air is basically used for two main
 purposes. Air used is mainly as compressed air which is created by using air
 compressor. The end product that is compressed air is then sent for various
 purposes depending on its main use. When it is used in the process it is called
 process air. When the compressed air is used for pneumatic purpose like Rota
 meters, pneumatic valves, which are directly linked to the main digital control room,
 it is called instrumentation air.

      At AIL Reciprocating air compressor is used. At AIL 350 CFM (cubic feet per
 minute) and 320 CFM AC is used, which are in stand by to each other. These are

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

 used for instrumentation air. There are three 100 CFM AC, out of this three, two are
 used for process air while the third one is used for making nitrogen gas.

     Power
      This utility is required and is often considered as the bloodline of the plant.

                  EXTRATION

 BOILER             TURBINE            GEARBOX             GENERATOR

                                                                      TRANSFORMER
 DE AERATOR             CONDENSOR

                                                                          TRIPPER

                                                                        3 Phases

      The turbine rotates at RPM of 9720. While AIL supply frequency of 50 hertz.
 Exposing the generator to such high RPM would lead to damaging of the generator,
 so for this introduce a gearbox whose primary aim is to lower the RPM. Here the
 gearbox used is specified in terms of the ratio of the turbine blade RPM to generator
 RPM. In order to give out power at 50 hertz, the generator must rotate at 1500 RPM.
 The gearbox is operated at a ratio of 6:4

       In the event that any of the major computer system fail, AIL have a back up
 system. The most important feature of the acid plant is revealed here. AIL operates
 the back up system in such a manner that the acid plant get top most priority this is
 done because the plant I is primarily steam producing unit which produces acid also
 using this steam AIL can run the diesel generator. AIL last option is to lower the
 load in the power plant, failing which the plant is asked to shutdown.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

     Raw water
      This utility is used mainly for the purpose of being made into steam. The
 largest supplier of this is the Gujarat board.

     Chilled water
       At AIL, two kinds of chillers are used. Thus AIL have ammonia based as well as
 Freon-22 as refrigerant. The cooling effect is measured in terms of “tones of
 refrigeration”

     Ammonia is used as a refrigerant because of particular thermodynamic
 properties which enable it to move heat far more efficiently than other refrigerant
 gases. It is particular suited to working to in the range approximately 0-15c and
 hence widely used in the chemical industries as well as other industries like food
 preservation and chilling of milk, dairy product, beer and cold drinks.

     Freon22 is used when AIL need temperature of -17c. The working principle
 remains same.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                         HEALTH AND SAFETY
     It is policy of AIL, Vapi to provide more suitable and endangers work to its
 workers. It’s also provided safety to visitor, as well as any other people.

     Occupational health and safety program are regularly conducted to achieve our
 common goal i.e. safety which has been as control of accidental loss.

 Emergency Exit:
       Provide at least two escape exit with clearly visible emergency sigh on
          every floor or in every room.

       Keep all the escape ways leading to emergency exit free from obstacles.

       Provide enough fire extinguisher of the appropriate type within every
          reach.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

 Safety Audit
     The purpose of this exercise is to review all plant and their process and
 operation of safety requirement to identify unsafe condition and practices improve
 safety and health at work place to prevent accident loss.

     Any safety officer or team of management carries out plant wise safety audit
 shell at least once in month.

 AARTI HEALTH CARE
  Aarti Healthcare is US-FDA compliant.

   API Division of AARTI        INDUSTRIES LTD., Flagship Company of USD 189

     Million “AARTI GROUP”, since 1976, exporting to more than 65 countries,

     including Developed and developing Markets.

   API   Division manufacturing APIs, in niche segments Viz: Anti – Hypertensive,

     Anti –Asthamatic, Anti-Cancer, Anti- Inflammatory / Anti- Allergic, Anti-

     Diabetic, Anti- Depressants, Anti- Thalassaemic. (Please refer to Product List).

   Manufacturing Units at Dombivali & Tarapur, in Maharashtra State of India, will
     be WHO GMP Approved facilities by End Dec.2003.

   Brand New facility upcoming at Tarapur & Vapi, per US-FDA Standard.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

   In house R & D Center, with Ultra modern, sophisticated Instruments, equipped
     with a Team of Highly skilled scientists, working round the clock on New

     Products and Process Improvements.

   Expected   to receive CoS for Ramipril, Budesonide, Venlafaxine, in year 2004,

     for marketing products in Western Europe.

   E-DMFs in CTD Formats available for most of the commercialized molecules.

   All products match specifications of BP / USP / EP, as applicable.

   Esteemed    clients in Domestic Market, serviced by us are, Ranbaxy, Sun

     Pharma, Cipla, Aristo , Astra- Zeneca Pharma India, Maral Labs., Cadila

     Healthcare, German Remedies, Intas, Biotrans, Dr. Reddys Laboratory (DRL)

   Per   individual client’s need, can also provide “Tailor Made Products” for

     physical parameters viz: Particle size (micronised material), Bulk Density etc.,

     as well Impurity profile, Methods for Testing etc.

   We also offer Intermediates of most of our APIs (Pl. refer to Product List).

   Products   under Patent will not be sold until Patent expiration in Buyer’s

     Country. Purchase of Patented Product will be sole responsibility of the Buyer.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                      SAFETY DEPARTMENT

     Safety is essentially meant for protecting human life and property. Elimination
 of unsafe condition in all the operating area and prevention of unsafe practices are
 given importance by the top management of AIL.

                        Structure of Safety department

                                 ASSISTANT
                                  DEPUTY
                                 MANAGER

      SAFETY                      SAFETY                       SAFETY
     ASSISTANT                    OFFICER                    INCHARGE

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                 ENGINEER                      SAFETY
                                             SUPERVISOR

 Safety slogan:
    Some of the safety slogans of AIL are as follows:

 “What is safety”?
    Safety means freedom from danger, security of life.

        “Safety begins with me”

        “Our aim zero accident.”

        “Safety saves sorrow/ it offer security and beings efficiency”

        “No safety know pain / know safety no pain”

        “Safety needs involvement”

        “Alert today tomorrow”

        “Accident brings tears/safety brings cheers”

        “With accident you gain / sorrow, sufficiency and pain”

        “A safety rules breaker is an accident maker”

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

        “Love is    the soul of life, fragrance is the soul of flowers, and energy is

           the soul of flower, sage productivity.”

        “No job is so important and no service is so urgent that we cannot take
           time, to perform or work safety, this time to do things safety can be the

           most important, time in our lives”

        “Working     to gather works, magic may be everywhere but there is no

           magic in safety. Just common sense.”

        “Care builds carelessness burns.”

 Goals of safety, health and environment are:

       To prevent injuries and personnel illness.

       To maintain work place and surrounding area safe and healthy.

       To eliminate any foreseeable occupational and environmental hazard that
          may result in fire and damage to property.

       To ensure that the ministry of labor, health, safety and welfare regulation
          are fully met with.

 General safety awareness:

         Smoking and consumption of tobacco is strictly prohibited.

         Do not run or jump on ladder.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

          Wash hands and rinse mouth properly before eating, take bath before

           going home.

          Don’t eat anywhere in the plant except in canteen.

          All employees should wear helmet and shoes in the plant.

          Don’t spill any oily substance on the floor.

          Use safety belts while working on high altitudes.

          Don’t repair any machine/equipments when it is operating condition.

          Use flame proof lamp near M.C.B, benzene, ammonia and methanol.

     AIL has many “Safe Assembly Point” and under ground tank for preserving
 the liquid acid. AIL has 71 boundary point of fire fighting points.

     The safety department conducts in plant safety training program on regular
  basis.

 Chemical       emergency,                                         prevention
 preparedness and response.
     Importance and use of safety equipment (Explosive, oxygen, CL-2, HCN,
  Monitors, SCBA, ESA, Fire Gas Tight Suit, First Aid-Box)

 Use of Personal Protective Equipment.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

    There are two type of PPE. They are

             Respiratory PPEs
             Non-Respiratory PPEs

 Respiratory PPE

        ö    Breathing Apparatus set used while handling gas leakages.

        ö    Canister mask used while cleaning vessels or reactor internally.

        ö    Air supply mask used while internal cleaning of vessels

        ö    Dust mask of protection against dust.

 Non-Respiratory PPE

        ë    Helmet for protection of head.

        ë    Ear plug/ear muff for protection against noise.

        ë    Face seal for protection of face.

        ë    Safety goggles for protection of eyes.

        ë    PVC suit for protection of body and clothes.

        ë    Hand gloves for protection of hands.

        ë    Apron for protection of clothes.

        ë    Welding shoes / safety shoes / gum boots for protection of legs.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

          ë   Safety belts used while working on height.

 Gas Leakage

         Wind direction is observed by seeing wind direction indicator. It is advised
          to go into the transverse (90 degree) or opposite direction and reach the
          safe assembly point.

         Only trained and persons equipped with Breathing apparatus set should
          go to the place of emergency.

         Make way for the rescue team or first aid team or emergency vehicle.

         If a person inhales gas take him to open place. Loose his clothes. Remove
          shoes and helmet. If he becomes unconscious, send him immediately to
          hospital.

 Chemical spillage
       If there is contact with face or eyes immediately wash below safety shower
          for at least 15 minutes.
       If chemical goes in mouth rinse properly with water.
       Contact the safety department for treatment.

 Emergency preparedness
       Water should be readily available at every point by means of fire hydrant.
       Fire extinguisher should be easily accessible in every plant.
       There should be wind direction indicator and siren.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

 Accident occurrences reporting system

     In case of fire a siren is blown twice at an interval of 15 seconds.
     In   case of gas leakage a siren is blown continuously four times for 15
       seconds duration.

     When situation comes under control a siren is blown for 1 minute.

 First aid
    First aid for some common accidents is as follows:

         Burn
         Shock
         Injury or cut
         Suffocation
         Eye injury
         Poisoning
         Fracture

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

 Housekeeping
     Accident because of inferior housekeeping.

         Scattered thing at work place.
         Things falling from above.
         Wet or oily floor.
         Tumbling over substances nearby.
         Fire because of inflammable things and loosely connected electrical
            wires.

     Sign of inferior housekeeping.
         Heaps of garbage and waste.
         Uncovered manholes.
         Improper hygiene at resting place
         Inadequate lighting
         Oily and wet floor.
         The machine with high speed is uncovered.

 Basis of housekeeping
     The management should inculcate housekeeping in every worker by
 impressing that with superior housekeeping the quality of the product can be
 improved and the factory as well as worker will progress.

     Inspection list for housekeeping
        a) Floor
        b) Lighting arrangement
        c) Ladders

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

        d) Fire extinguisher
        e) Surrounding bushes and plants.

     Advantage of housekeeping
        a) Work will be fast and safe
        b) Health of worker will be good.
        c) Workers will feel secure.
        d) Relation between worker and management is improved
        e) Quality for the product is enhanced
        f) Everyone will be disciplined.

     Runway reaction(thermal explosion):
     It’s the consequences of the loss of control of the temperature of chemical
 compound or a reaction mixture in an enclosure.

     Consequences of runway reaction:-
         i.   It results in the emission of a two phase mixture of gas and liquid to the
              atmosphere giving an aerosol.
        ii.   In open air aerosol can ignite due to oxidation of hot gases and
              droplets with air of possibly to the occurrences of electric sparks.
       iii.   The emission of reaction mixture in housing area can cause serious
              problems.

     Causes of runway reaction:-

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

            i.    Any deviation from process condition.
           ii.    Lack of experimental information necessary for risk assessment,
                  choice of safe choices.
          iii.    Lack of consequence of runway reactions.

 Types of thermal explosions:-

     a)    Homogenous thermal explosion :- it includes
                  Reactor under heating condition.
                  Reactor under cooling condition.
                  Reactor under heating condition with high heat flux applied.
                  Other initiating agent.

     b)    Heterogeneous thermal explosion:- it includes
                  Storage vessel hazards
                  Process deviation parameters
                  Fast propagating reactions

 SAFETY HEALTH AND ENVIRONMENT POLICY
                                   (SHE POLICY)

     "As a responsible organization engaged in the business of manufacturing
 chemicals, we, at AARTI INDUSTRIES LIMITED, Vapi, shall strive to ensure
 improvement in all aspects of our Safety, Health and Environment (SHE)
 performance related to our activities, products and services, through an effective
 implementation, monitoring and periodic review of the designed SHE Management
 System."

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

 With respect to the above, we pledge to:

           Ensure continual improvement in the SHE Management System

           Comply with applicable SHE legal requirements

           Institutionalize effective resource management, with a specific focus on
             energy, water and basic raw materials

           Strengthen pollution prevention & waste reduction practices and strive
             to provide a safe and healthy environment

           Enhance SHE Management System awareness about the desirable
             practices to be followed by employees and other concerned

             stakeholders, through proper communication.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

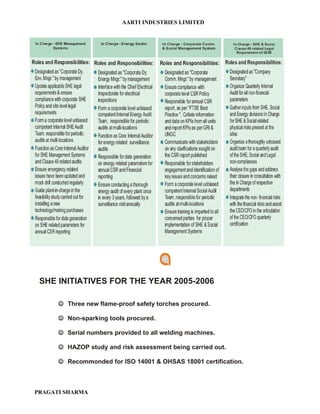

 SHE INITIATIVES FOR THE YEAR 2005-2006

       Three new flame-proof safety torches procured.

       Non-sparking tools procured.

       Serial numbers provided to all welding machines.

       HAZOP study and risk assessment being carried out.

       Recommonded for ISO 14001 & OHSAS 18001 certification.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

       Specific focus on conservation and reduction in consumption of primary

         raw materials, energy and water.

       Scrubber system for NOx & HCl modified for better efficiency.

       Online Benzene sensor installed in MCB Plant.

       Implemented the new hot work permit system. Started providing fire

         extinguisher from safety dept. to avoid misuse of plant fire extinguishers.

       Air moisture removal filter installed in fresh air line in chlorine shed.

       Implemented the safety work permit system for CNA and Methanol tanker

         unloading.

       Acid spillage transfer arrangement made during emergency in Acid plant.

       Emergency training imparted for dealing with cyclones.

       Special training sessions organized on skin diseases, AIDS, First Aid and

         M.S.D.S. by inviting external experts.

       Leaflets in Hindi & Gujarati language for emergency preparedness

         distributed to all employees.

       Formulated fire-fighting and rescue squad and trained them to be ready for

         tackling any emergency.

       Hepatitis 'B' injection given to all employees and family members.

       Pre-employment medical check-up & yearly medical check-up of existing

         employees carried out.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

        Eye test of all DMS employees done. Power with photo chromic/without

          photo chromic lens provided to all DMS employees.

        Conferring of the Best Housekeeping Award started.

        World Environment Day celebrated on 5th June. GPCB members were

          present on this occasion.

        Complied with all legal requirements.

          AARTI IN THE PROCESS OF HANDLING
                HAZARIOUS CHEMICALS
     AARTI has developed considerable expertise in the reactions mentioned
 below & in handling the hazardous chemical involved therein. AARTI also has
 wealth   of   experience   in   unit   operations   such   as   DISTILLATION   &
 CRYSTALLISATION. Based on these experiences, AARTI is strategically placed to
 undertake customized synthesis of organic chemical products.

 CUSTOM SYNTHESIS IN FOLLOWING REACTIONS

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

       •   Nitration
       •   Reduction
       •   Condensation
       •   Oxidation
       •   Sulphonation
       •   Methoxylation
       •   Acetylation
       •   Grignard Reaction
       •   Aldol Condensation
       •   Acylation
       •   Alkylation
       •   Michael Addtion
       •   Esterification (Including Asymmetric Esterification)
       •   Meerwin - Pondorf - Verley Reduction
       •   Cyclocondensation
       •   Epoxidation (Chiral & Achiral)
       •   Dehalohydrogenation
       •   Noble Metal Hydrogenation (Catalytic Reduction)
       •   Fischer Indolization
       •   Ammonolysis (Amidation)
       •   Balz - Schiemann (Halex)

       •   Halogenation (Cl, Br, I)
       •   Hydroxylation
       •   Vilsmeier - Haack Formulation
       •   Ullmann Substitutions
       •   Kolbe - Schmidt Carboxylation
       •   Diazotization & Related Chemistry
       •   Oppenauer Oxidation
       •   Friedel Craft
       •   Japp - Klingemann
       •   Sharples Oxidation

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

       •   Birch Reduction
       •   Cyanation

 EXPERTISE IN HANDLING HAZARDOUS CHEMICALS

       •   Benzene
       •   Liquid Chlorine
       •   Hydrogen
       •   Liquid Ammonia
       •   Thionyl Chloride
       •   Sulphur Trioxide
       •   Sulphur
       •   Dimethyl Sulphate
       •   Chloro Sulphonic Acid
       •   Potassium Fluoride
       •   Concentrated Nitric Acid
       •   Hydrogen Fluoride

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                MAINTENANCE DEPARTMENT
     The maintenance of plant is important for the smooth running of any company.
 AIL following three types of maintenance are done. They are as follows
         Electrical maintenance
         Civil maintenance
         Mechanical maintenance

 Electrical maintenance
     The electrical maintenance includes the maintenance of the following factor:

        a. Motors
        b. Telephone system
        c. Electrical installation
        d. Switch gears
        e. Meters
        f. Generators
        g. Lighting
        h. Fans

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

 Civil maintenance
     The civil maintenance mainly includes the maintenance of the following. They
 are as follows:

           a. Building construction
           b. Service facilities (water, A/C, ventilation)
           c. Fire fighting
           d. House keeping
           e. Scrap disposal
           f. Janitor

           g. Gardening
           h. Drainage

 Mechanical maintenance
       The mechanical maintenance mainly includes the following factors:

           a. Machine and equipments
           b. Transport vehicles
           c. Material handling equipment
           d. Steam turbine and electricity.

 Type of maintenances used in AIL:
       •    Reactive maintenances.
       •    Preventive maintenance.

 Benefits of locations
           It is an GIDC area
           Convenient in infrastructure.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

         Easy availability of local employment.
         Convenience in transportation through rail and road
         Good earnings.
         Availability of market
         Better communication system
         Availability of water and electricity supply

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                EFFLUENT TREATMENT PLANT
     All the AARTI’s large scale manufacturing units have their own Effluent
 Treatment Plant (ETP) with facilities for Primary, Secondary and Tertiary treatment
 of effluent. In Sarigam, Gujarat, under the initiative of AIL, all the small units have
 formed a new company named "Perfect Enviro Control Systems Pvt. Ltd." and have

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

 set up a Common Effluent Treatment Plant, which is the first private ETP facility.
 This effort has been well appreciated by the World Bank. Our other small
 manufacturing units are the members of the Common Effluent Treatment Plants in
 their respective regions.

     ETP section play very important role in AIL. In this section there is only two
 person’s working. The HOD of this section is Mr. Maruti Patil.

 Responsibility
     The following are main responsibility of ETP section:

        They control total area of south Gujarat.
        They provide training to employees about function of computer.
        All the maintenance and repairs of computers.
        They provide software program as well as hardware function to other
          department of the organization as per requirement.
        Proper watch the user about their proper function.
        It after training also, employee is not proper working inform to General
          Manager.
        If there is any break down of system, it is their responsibility to provide
          and make workable as soon as possible.
        They provide new developed programmers to required department
        Purchase of system is also the responsibility of ETP section.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                                                        DECANTER
                         OLD NEUTRALIZER
                                                       CENTRIFUGE

    STORE
                                                PRIMARY
   WATER PIT          EQUALIZATION TANK                             BIOREACTOR
                                               CLARIFIER

                                            SLUDGE
                                           COLLECTOR

         ACTIVATED
          CARBON                V-NUTCH           REFINEMENT            SECONDARY
          COLUMN                CHAMBER              TANK                CLARIFIER

       FINAL OUTLET
                                                                    SLUDGE DRYING
         CHAMBER
                                                                        BED

     Effluent is any waste material produced during the course of various
 manufacturing process in any industry or for that matter chemical industry. Waste
 water can be classified as:

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

          Domestic waste water.
          Process waste water.
          Cooling waste water.

         To treat this waste water before letting it anywhere is mandatory and requires
 a series of stepwise systematic processing called as “Effluent treatment plant”.

        It is also very important to meet the ever increasing stringent emission norms
 of Pollution control boards; AIL is controlled by G.P.C.B. (GUJRAT POLLUTION
 CONTROL BOARD), which is the controlling authority; hence the need for studying
 ETP.

  The stepwise working of the ETP here can be explained as follows:-

        1) STORE WATER PIT:-

        The effluent from various plants first comes to a holding tank where oil, Grease
 and solids are separated. The remaining stream goes to the equalization cum
 neutralization unit via 3 pumps of 5 HP, 10 HP, and 10 HP and flow rate of 8m/hr.

        2) EQUALIZATION TANK:-

      It’s the heart of ETP, because all the variations occurring in the plant is
 stabilized here. It’s a simple tank with a capacity provided 15% extra considering

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

 emergency situations. Here we have two equalization tanks. Here we can add some
 neutralizing, coagulating and flocculating agents.

      The tiles of the equalization tank are made of a resin called as C.N.S.S.L. and
 are acid proof. The mastic work consist of lining of brick tiles

     3) DECANTER CENTRIFUGE:-

     After neutralizing by caustic, we send it to flash mixer where we add
 polyelectrolyte (heavy resins) to flocculate the small particles to from bigger
 particles. Then the stream is sent to primary clarifier. The input stream is sent to
 primary clarifier. The input stream of slurry to the decanter centrifuge should be
 maintained below 20%.

     4) PRIMARY CLARIFIER:-

       Basically it is like a sedimentation process where smaller particles are
 coalesced and then separated. For this an agitator where a proper RPM is
 maintained is required, so that the particles are coalesced and not broken and our
 objective is achieved. The heavy particles settle down and removed as sludge
 drying bed. About 80% treatment is done in primary clarifier.

     5) BIO-REACTOR:-

       The overflow of the primary clarifier goes to the bioreactor where bacteria are
 fed with food and nutrients like jaggery, diammonium phosphate (DAP), etc. the

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

 bacteria averages 0.5 to 1 micrometer in diameter. Some standard conditions are
 required to be maintained which are as follows:-

              PH:     It is maintained between 5.5 to 6.5 for minimum impact on the
                environment. Bicarbonate alkalinity is required to keep this pH at right
                levels.

              Temperature:     It normally ranges from 25 to 30 C.

              Dissolved oxygen:      The bacterium requires some additional oxygen
                for their survival. The minimum value to be maintained is around 5
                mg/L. for this an agitator is used.

       We use Activated Sludge Process (ASP) with recycle.

         The outlet of bioreactor goes to secondary clarifier. It works on similar lines
 as of primary clarifier.

      6) ACTIVATED CARBON COLUMN :

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

     The overflow of the secondary clarifier goes to activated carbon column via a
 polishing tank and V-nutch chamber. Here we have a sand column followed by
 activated carbon column where the remaining effluents are absorbed.

    The column is regenerative type of column.

     7) SLUDGE DRYING BEDS:-

     The bottom of the primary and secondary clarifier goes to sludge drying beds,
  which are two in number and are essentially sands beds. The water from this along
  with the activated carbon bed outlet is to equalization vessel.

     The sludge is packed in gunny bags and sent to sludge waste management
  company ltd. (S.W.M.C.L.).

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                           SWOT ANALYSIS
    STRENGTHS
       It had strong technical base with the core whole time director being
         technocrats with sound entrepreneur skills.
       The company being a multi location, multi product entity has
         manufacturing abilities for a large number of products which enables them
         to change of product mix as per market demands.
       In house research and development centers recognized by the department
         of scientific and industrial research enables continuous research for new
         products process improvements, energy consumption reduction etc.
       The company has a large customer both local and international. The
         company has strived to serve them with loyalty since inception. It is the
         support of these customers as well as that of its supplier that has enabled
         the company to sustain its growth.
       The company has always given priority to environment, health and safety.
         It has technologically upgraded efficient treatment facilities at all its units.
       The company is having an additional advantage which includes stocking
         points in US, Europe, Japan and Logistics Advantage.

    WEAKNESS

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

       House keeping is not up to the mark.
       Centralized decision making which many a times hinders the functioning
         of different departments.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

    OPPORTUNITIES
       The company is stream lining its new units at Vapi and Tarapur for custom
         synthesis and USFDA approved pharmaceutical manufacturing.
       The company is also working out marketing tie-ups with multinational for
         its existing and new range of product.
       The company has a large customer base comprising multinational and
         global majors. This fact coupled with the in house, competent R&D team
         gives opportunities to increase volumes in existing products and to
         introduce new products.

    THREATS

       The company’s threat perception is the shifting of some of its end usage
         product to china. Accordingly the company is making continuous efforts
         to increase its presence in china.
       The company’s ability to change its product mix quickly, its vast range of
         products numbering about 75% and its foray into specialty chemical and
         pharmaceuticals also makes the company confident of countering this
         threat effectively.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                             INDEX
                        PART 2 (SPECILIZATION)

 SR. NO                    TOPIC                    PAGE NO

    1     HUMAN RESOURCE AUDIT                        1-13

                INTRODUCTION                          1-2
                CONDUCTING A HUMAN RESOURC AUDIT       3
                GOALS OF THE AUDIT                     3
                FOCUS OF AUDIT                         4
                WHY DO AN AUDIT                        4
                PRELIMINARY STEPS                      5
                WHAT DOES AN HR AUDIT COVER           5-6
                DATA COLLECTION METHODS                7
                CODES OF CONDUCT                     8-13
                o CODE OF CONDUCT OF AIL              8-13

    2     HR AUDITING OF AARTI INDUSTRIES LIMITED    14-45

              INTRODUCTION                          14-18
              HUMAN RESOURCES PLANNING               19
              RECRUITMENT AND SELECTION             20-22
              EDUCATION, TRAINING, AND              23-26
               DEVELOPMENT
              o EDUCATION AND TRAINING               23-24
              o EMPLOYEE DEVELOPMENT                 25-26
             LEAVES OR EMPLOYEE ENTITLEMENTS         26

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                PERFORMANCE MANAGEMENT              27-28
                COMPENSATION                        29-32
                LABOR RELATIONS & EMPLOYEE          33-34
                 RELATIONS
                DIVERSITY AND EQUAL EMPLOYMENT      35-37
                 OPPORTUNITY
                SAFETY AND ENVIRONMENT              38-41
                DOCUMENTATION & INFORMATION          42
                 SYSTEMS

    3     FORMS                                       43

    4     LIMITATIONS                                 44

 SR. NO                     TOPIC                   PAGE NO

    5     FINDINGS                                   45-46

    6     RECOMMENDATIONS                             47

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                       HUMAN RESOURCE AUDIT

     An Audit is a means by which an organization can measure where it currently
 stands and determine what it has to accomplish to improve its human resources
 function. It involves systematically reviewing all aspects of human resources,
 usually in a checklist, ensuring that government regulations and company policies
 are being adhered to. The key to an audit is to remember it is a learning or discovery
 tool, not a test. There will always be room for improvement in every organization

     Audits help determine the effectiveness of an HR department and/or HR
 systems. They are a systematic, objective tool to assess regulatory or policy
 compliance in the workplace.

     Often in assessing a company’s business practices and legal compliance, the
 emphasis is on the company’s financial records. It is equally important, however, to
 assess HR policies and practices, including the less concrete and less tangible
 areas that deal with employee dignity and well-being. These are harder to measure,
 but their impact on productivity can be significant. Additionally, poor business
 practices can lead to very expensive legal sanctions. Just Audits help determine the

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

 effectiveness of an HR department and/or HR systems, audits can be valuable tools
 in assessing HR policies and practices and ensuring that the company maintains a
 safe and respectful work environment.

      Human resources and the HR department perform a wide variety of activities.
 The audit works best when the focus is on analyzing and improving the Human
 Resource function in the organization.

      The Human Resources (HR) Audit is a process of examining policies,
 procedures,    documentation,     systems,     and   practices    with   respect   to   an
 organization’s Human Resource functions. The purpose of the audit is to reveal the
 strengths and weaknesses in the organization’s human resources system, and any
 issues needing resolution.

      The audit itself is a diagnostic tool, not a prescriptive instrument. It will helps to
 identify what you are missing or need to improve, and it may even tell you what you
 need to do to address these issues. It is most useful when an organization is ready
 to act on the findings, and to evolve its HR function to a level where it’s full potential
 to support the organization’s mission and objectives can be realized.

      HR audits typically are conducted in the workplace itself, with the HR
 department using a multipoint checklist defining those "must haves" to ensure that
 a company is legally compliant under both state and national government
 regulations. The audit specifies conditions that should be met and then determines
 whether they are or are not. Often, interviews are conducted randomly with
 employees and managers to determine the culture or climate with regard to
 acceptable/unacceptable behaviors in the workplace. Once an HR audit is
 conducted, a company will know exactly what needs to be done to ensure its legal
 compliance.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

     Depending on the size of the organization, the number of workplace facilities
 and other complexities, an audit can take anywhere from a half a day to several days
 to conduct.

 CONDUCTING A HUMAN RESOURCES AUDIT.
     As the Employment law is an ever-changing field. The company’s policies and
 procedures must change with the laws if the company hopes to avoid litigation.
 Employers are aware that one of the best ways to avoid employee lawsuits is to
 have a comprehensive policy manual. That’s good advice, but it’s not enough. So all
 the companies must regularly conduct human resources audit.

 GOALS OF THE AUDIT.

     The goals of conducting audit’s are

    o To determine whether company’s policies are being applied consistently and
       whether they are consistently communicated to all employees.

    o Are the mission and strategy of the human resource organization designed to
       match the business strategy of the organization?

    o Are the kinds of people who run the human resource function good choices
       for the ongoing tasks?

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

    o It should distinguish between policies that are applicable to nonunion
        employees, and the terms and conditions of employment for employees who
        are represented by a labour organization.

    o Finally, the review process should provide answers to several important
        questions regarding the application of company’s policies.

 FOCUS OF AUDIT.
 The focus while conducting an Audit will be on:

              What unit is to be analyzed?

      In large corporations, the focus of the audit can be the total corporate
 personnel / human resource management function, or it can be the divisional or
 subsidiary level. Whatever the focus, the audit's boundaries must be specified from
 the start.

 My focus of auditing was human resource department manager.

 WHY DO AN AUDIT

         To insure the effective utilization of an organization’s human resources.

         To review compliance with a myriad of administrative regulations.

         To instill a sense of confidence in management and the human resources
              function that it is well managed and prepared to meet potential challenges.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

        To maintain or enhance the organization’s and the department’s reputation
          in the community.

PRELIMINARY STEPS
     There are two issues that must be considered before implementing an
 employment law Audit:-

             ö When should the audit take place?
             ö Who should conduct the audit?

     Since the Municipality already utilizes a variety of employment-related
 practices and procedures, the audit should be conducted as soon as possible, if
 you have never audited such procedures before. After the initial audit, follow-up
 audits should be conducted annually. When putting together an audit team, include
 either in-house or outside legal counsel, a representative from Human Resources,
 or any other individuals needed to represent a cross-section of staff functions. All
 team members should be warned ahead of time regarding the handling of
 confidential information.

 WHAT DOES AN HR AUDIT COVER?
     The HR audit is broken into areas of evaluation that include what is needed
 before a company hires any employees all the way through the process of recruiting
 new employees, bringing them aboard, enrolling them in benefits programs,
 safeguarding their confidential information, managing and supporting them, and
 participating in their exit from the company, if necessary, either voluntarily or
 otherwise

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

     While conducting the auditing in AARTI INDUSTRIES LIMITED I tried to cover
 each and every point among them are the HR planning, recruitment & selection,
 leaves, training and development, benefits, compensation, diversity and equal
 employment opportunity, performance appraisal, employee relations, safety and
 environment, documentation and information system and also the forms that are
 available on the spot while conducting the auditing in the AIL.

 What does a full HR Audit entail"?

     Generally the HR audit involves the following things in it:

         Legal compliance

         Compensation/Salary Administration

         Employment/Recruiting

         Terminations

         Training and Development

         Employee Relations

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

        Communications

        Files/Record Maintenance/Technology

        Policies and procedures (including employee handbook)

 DATA COLLECTION METHODS
    The sources of collection of data are the

       •   Primary source
       •   Secondary source

 The primary sources of data are:

    The sources from where the data can be collected are as follows

          Interviews with Senior Management: Focus on strategy and a definition
           of the current state of the organization and the desired future state.
          Interviews and Questionnaires with Line Management: Focus on their
           interactions with the HR function, their human resource problems, and
           the role they envision for the HR organization.
          In-Depth Questionnaires from the Human Resource Staff: Diagnose the
           jobs, activities, conflicts, and internal strengths and weaknesses of the
           function.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

           Archival Information and Documents: Describe job histories, past
            evaluations,    formal   structures,   and   general   background   on   the
            organization as a whole and the HR function in particular.

     The primary source of data was used to collect the information that consisted
 of in-depth Questionnaire: to the Human Resource Manager covering almost all
 points that a human Resource Audit should involve.

 Secondary source of data are:

     The secondary source is where the data are readily available. The secondary
 source was not used / considered.

 CODES OF CONDUCT

     Codes of conduct detail issues that are not regulated by law but are the
 standards, behaviours and expectations set by the employer in the workplace.

     Policies associated with codes of conduct may cover matters such as: fighting,
 language, dress standards, alcohol, drugs, smoking, and confidentiality, other
 employment, maintaining the workplace, taking care of organization property, theft,
 and statements to media.

         CODE OF CONDUCT FOR THE BOARD MEMBERS
              AND SENIOR MANAGEMENT OF AIL

INTRODUCTION
     As required under Clause 49 of the Listing Agreement as amended up to date,
 AARTI Industries Limited (herein referred to as “the Company”), hereby notifies the

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

 “Code of Conduct for the Board Members and Senior Management of AARTI
 INDUSTRIES LIMITED” (hereinafter referred to as “the Code”).

     All the Directors and members of the Senior Management are mandatorily
 required to understand and adhere to the code/standards prescribed herein,
 including any amendments /modifications/ replacements thereof as may be notified
 by the Board of Directors of the Company from time to time, in the course of their
 dealings, exercise of powers and discharge of their duties, responsibilities and
 obligations in relation to the Company and its transactions.

     Nothing in this Code of Conduct or related communications creates or implies
 an employment contract or term of employment.

 VIOLATIONS OF LAW

        Violations of law, this Code of Conduct or other Company policies or
          procedures should be reported immediately to the Managing Director and/

          or the Compliance Officer in writing.

        Violations of law, this Code of Conduct or other Company policies or
          procedure can lead to disciplinary action up to and including

          termination/vacation of office.

 APPLICABILITY
     This code shall be applicable to all the Board Members (referred to as
 `Directors’) and Senior Management of the Company.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                          PART A – DEFINITIONS

 'COMPANY’

      Means AARTI INDUSTRIES LIMITED

 'BOARD MEMBERS’

      Means Board of Directors of AARTI INDUSTRIES LIMITED

 'SENIOR MANAGEMENT’

      Means, personnel of the company who are members of its core management
 team excluding Board of Directors (BOD). This would comprise of all members of
 management one level below the executive directors, including all functional heads.

 'COMPLIANCE OFFICER’

      Means the office appointed by the BOD for the purpose of this code from time
 to time.

                         PART B – COMPLIANCE

 COMPLIANCE OFFICER

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

     The Company has appointed Mr. Mohan P. Sonar, Company Secretary as
 Compliance officer for the purpose of this Code and he shall report to the Managing
 Director of the Company.

 AFFIRMATION OF COMPLIANCE

     All Board members and senior management personnel of the Company shall
 affirm compliance with this Code on annual basis in such form as may be
 prescribed and send it to the Compliance Officer by 30th April each year. The
 Annual report of the company shall contain a declaration to this effect.

                      PART C - CODE OF CONDUCT
      The Directors and Senior Management personnel of the Company shall adhere
 to the following:

     1. Shall act in accordance with the highest standards of personal and
         professional integrity, honesty and ethical conduct

     2. Shall be independent in their judgment and actions.

     3. Shall exercise due care and diligence in performance of their duties.

     4. Shall comply with all applicable laws, rules, and regulations.

     5. Shall not engage in any business, relationship or activity, which may be in
         conflict of interest of the Company without prior approval of the Board.

     6. Shall intimate the Company’s Board of Directors before accepting outside
         directorships.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

    7. Shall maintain the confidentiality of the information about of the Company
        received/obtained by them in the course of their position as Director
        /employee of the Company, except when disclosure is authorized by the
        Chairman and/or Vice Chairman and Managing Director of the Company or
        legally mandated and shall not use confidential information for their own
        advantage or profit.

    8. Shall use best endeavors to protect Company’s assets and property and
        ensure its efficient use.

    9. Shall not derive any personal benefit (including without Limitation through
        the use of Company’s property, assets, information, or position) except that
        which they are lawfully entitled to

   10. Shall refer all inquiries or calls from the press and financial analysts to the
      Company’s Managing Director. The Company has designated its Chairman,
      Vice Chairman and Managing Director, Vice Chairman, as official Company
      spokespeople for any company related matters.

   11. Shall abide by AARTI’S internal code for prevention of Insider Trading.

   12. Shall not, directly or indirectly, short sell any equity/security, of the Company
      so as to make gain out of such sale or otherwise. A short sale means any
      transaction whereby one may benefit from a decline in the Company’s share/
      security price.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

   13. Shall not derive any benefit (directly or indirectly) or assist others to derive
      any benefit by giving advice from the access to and possession of price
      sensitive information about the Company, which are not in public domain.

   14. Shall not exploit for their personal benefit, opportunities that are discovered
      through Company’s business, information or position, unless the same is
      disclosed fully to the Managing Director and permitted by him.

   15. Shall not compete directly or indirectly with the business of the Company or
      with any business that the Company is considering to establish.

   16. Shall    treat   women   employees    equally     and   eliminate    any    gender
      discrimination and shall avoid harassment/threatening based on race, color,
      religion, age, gender, national origin, disability or any other basis.

   17. Shall not misuse the Company’s facilities, except where such facilities have
      been provided for personal use either by policy or by permission or authority
      or in the normal course of business. The Company’s facilities shall not be
      used for personal use and even when used with prior approval, care shall be
      exercised / taken to ensure that costs are reasonable.

   18. Shall not (directly or indirectly) accept or retain any gift, entertainment or
      other benefits from any organization or person doing business or competing
      with     the   Company.   However,    they   may   accept   and      offer   nominal
      gifts/hospitality which are not of material value and are customarily given on
      accessions or are of commemorative nature for special events.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

    19. Shall affirm compliance with this Code to the Company on an annual basis.

 (THIS CODE IS SUBJECT TO REVISION. SUCH REVISION
 SHALL BE WITH THE APPROVAL OF THE BOARD)

      THE HR AUDITING OF AARTI INDUSTRIES
                    LIMITED

  Information of the company & person, where auditing was conducted.

 COMPANY NAME–

     The company in which the auditing is to be conducted is to be properly known
 that what are the name in which the company has registered itself and the name in
 which the company is trading.

     REGISTERED AS: M/S AARTI INDUSTRIES LIMITED

     TRADING AS: M/S AARTI INDUSTRIES LIMITED

 COMPANY’S URL–

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

     The URL of the company helps to gain information about the company. The
 information can be about the products, their company, and if anything new is
 happening.

                        The URL of AIL is www.aartigroup.com

 NAME OF THE PERSON –

     Name of the person was Mr. Kirit G Sashtri.

 DESIGNATION–

     The designation of the person was HR Manager.

 CONTACT–
     Contact of Mr. Kirit Sashtri is

     CELL NO: 9377804595

 ADDRESS OF THE COMPANY–
     The address of AIL is as follows.

     REGISTERED OFFICE                   CORPORATE OFFICE
     Plot No. 801,802/23,                Udyog Kshetra,
     GIDC Estate, phase III,                  2nd floor, L.B.S. Marg,
     VAPI_ 396195,                            Mulund-Goregaon link road,
     DIST. Valsad, Gujarat.                   Mulund (W), Mumbai 400 080.

 TYPE OF COMPANY–

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

        The company is a Chemical Company.

 TOTAL NO OF EMPLOYEES –

    •    The total numbers of employees working in the AIL is 503.
    •    Among them 180 are in staff.
    •    There are no casual employees.
    •    323 employees are doing the job of operators and
    •    There are 250 contract workers.

 DEPARTMENT MISSION –
        Firstly the overall objective or purpose of the human resources department
 within the Organization and its relationship to the Organization's overall mission is
 to be known.

        The mission of the human resource department of AIL is as follow:
    •    Taking care of employee welfare,
    •    Emphasize on appropriate training to all the employees and be open to all
         their suggestions through team participation.
    •    Maintaining health care system in the company.

 The further questions asked were:

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

       The overall objective or purpose of the human resources department within
        the organization to the organization's overall mission is linked or not?

                     YES (  )                    NO (   )

       ANS: The department’s mission and that the organization’s mission is
              linked to each other or not is also important to glimpse.

              And it was found that the organization purpose was matching with
              the human resource department objective.

       Does the company have formal HR manual?

                     YES (   )                    NO (  )

       ANS: AIL does not have any HR Manual or any manual for their employee.

       Are all he key policies covered in the manual?

                     YES (   )                    NO (  )

       ANS: As there is no employee manual the policies also does not exist at
              AIL.

       Working hours of the employees?

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

    ANS: The working hour of employees is 8 hrs. There are 3 shifts in 24
           hours.

    Overtime hours?

    ANS: The over time is usually not there but if there is some urgent order
           which is to be prepared for that the company asks the employees/
           workers to do overtime for which they are paid separately.

    What is the official retirement age?

    ANS: The retirement age decided and specified by the AIL to its
           employees is 58 years.

    Does the company offer education assistance to the employees
      children?

                  YES (  )                    NO (   )

    ANS: The children of the employees are given education assistance by
           the AIL. Education assistance is on the merit of the students. The
           student who scores good marks is given education assistance.

    Does any employee work from home?

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                  YES (   )                    NO (  )

     ANS: There is no policy as such in AIL according to which any employee
             can work from home.

     Is the turnover rate high than expectation?

                  YES (   )                    NO (  )

     ANS: The turnover ratio of AIL is not too high if truth be told not many
             people leave the company and go.

 HUMAN RESOURCES PLANNING –

     The Human Resource Planning means the prior planning of the human
 resource. How the company pre plans for the people to recruit and select in the
 organization is to be known.

     Do you know your employment needs beyond the current year?

                  YES (  )                         NO (   )

     ANS: According to the employee turnover. Also that now the company is
             expanding itself, the company needs human resource.

     Have you engaged in a strategic planning process to clarify your
      employment needs?

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                 YES (  )                           NO (    )

     ANS: The department heads if they need more employees under it, gives a
             written letter demanding employees under them and the reason why
             they require more employees.

 RECRUITMENT AND SELECTION –
     Recruitment and selection is obtaining and evaluating qualified candidates
  from internal and external sources for positions throughout the Organization.

     The Human Resource Manager of AIL was asked these questions on the
  recruitment and selection topic.

    Is the selection process transparent, equitable, based on merit, and
     appropriate?

                 YES (  )                           NO (    )

     ANS: The AIL has a recruitment process in which every candidate is equal and
             there is no biasness which can take place. The recruitment is done with
             complete honesty and the process is completely based on the merit

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

              and the performance of the candidate in the interview, recruitment and
              the selection process.

    Are new employees provided with a comprehensive induction?

                  YES (  )                           NO (   )

       ANS: The new employee in the AIL is given a formal introduction and then
              made familiar with the people whom he is going to work with. This is to
              make him aware of the company, people and the environment in which
              he is going to work with.

       Before filling a position do you identify the skills, qualifications and
        behaviours of candidate, needed to meet your objectives?

                  YES (  )                           NO (   )

       ANS: The AIL while conducting the recruitment and the selection process
              notice the attitude and the behaviour of the candidates. Through the
              response or the answers of the question asked to the candidates the
              AIL (people conducting the recruitment process) come to know
              whether the candidate is competent for the job or not.

    Do job descriptions exist?

                  YES (  )                           NO (   )

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

    ANS: While recruiting the candidate to his post the company gives a complete
           description about

                 1. What is his job?

                 2. What he is going to do?

                 3.   What duties and responsibilities that he is going to perform?
                      Etc...

    Are job descriptions up to date?

                  YES (        )                    NO (  )

    ANS: In AIL the job description exists in the AIL but it is not reviewed or
           updated by the company.

    Are applicant references checked?

                  YES (        )                    NO (  )

    ANS: The AIL checks the reference of their newly if they find it necessary.
           Normally employee reference is not checked.

    Are turnover rates monitored?

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                 YES (   )                     NO (  )

     ANS: The AIL does not monitors the employee turnover rate.

    Is the selection procedure clearly told to the candidates?

                 YES (  )                           NO (   )

     ANS: The Company informs the candidates previously itself about the
             procedure of the selection so that there is no confusion in the mind of
             the candidates regarding the procedure.

 EDUCATION, TRAINING, AND DEVELOPMENT –

     Providing performance skills training and career development to employees,
 utilizing both internal and external resources, includes providing expertise in
 assessing education, training, and development needs and identification of high-
 potential employees.

     The AIL was asked these questions on the education, training and the
 development of their employees.

   EDUCATION, TRAINING, AND DEVELOPMENT

    Do you provide performance or skills improvement training?

                 YES (  )                           NO (   )

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

    ANS: If any employee is not that competent and needs training then that
           employee is given training to improve his skills, performance and work
           quality.

    Do you utilize both internal and external resources for training?

                 YES (  )                          NO (    )

    ANS: The AIL uses both internal as well as external sources for the training.
           The internal training is where the trainer from the company itself. And
           in the external training the company asks the institutes to give training
           to their employees.

    Does the training include expertise in assessing education, and
     development needs?

                 YES (  )                          NO (    )

    ANS: Suppose if there is any safety training then a safety expert is being
           called and asked to give the training so that if there is any technical
           problem which is not understood by the employee then it is being
           solved by the experts.

    Are seminars held in the company?

                 YES (  )                          NO (    )

    ANS: The Company some times conducts seminars for their employees and
           for their benefits.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

    Do you offer employee in house training by the companies employees
     only?

                 YES (  )                           NO (   )

    ANS: The Company also gives the employees training from the senior
           employees working in the company.

    Do you offer external training source?

                 YES (  )                           NO (   )

    ANS: The AIL does offer external training more than the internal training as the
          experts are being called for giving training to their employees.

   EMPLOYEE DEVELOPMENT

    Do you have a way to identify the employees development needs of
      your employees? ( e.g. surveys, reviews, performance management)

                 YES (  )                           NO (   )

    ANS: The AIL identifies the employees development needs as the AIL gives
           training to their employees and if any of the employees work or
           performance is not good they come to know that the employee is not
           developing. The company goes for the performance management as
           away to know the development need of an employee which is
           conducted at the year ending.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

    Do employees in your work area get the development they need to do
      their jobs effectively?

                 YES (  )                          NO (   )

    ANS: The development is through the training that are given at regular period
            to all the employees and motivated for good work.

    Do you monitor the results of employees’ development activities in
     order to assess their effectiveness?

                 YES (  )                          NO (   )

    ANS: The AIL once in the end of the year sees that which are the employees
            who are to be given a promotion and development. The employee who
            performs well is been promoted.

    Are new employees offered mentoring support?

                 YES (  )                          NO (   )

    ANS: The AIL does give mentors support to its new employee so that the
            mentor helps the employee in understanding the work and help the
            employee if he faces any problem while working.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

 LEAVES OR EMPLOYEE ENTITLEMENTS

       The leaves given to the employees also do matter that how many days in a year
 they have leaves and how many days they get leaves with no harm in their pay.

      Total annual leaves: given by the AIL to its employees is 7 days.
      Total sick leaves: is 9 days leave annually.
      Privilege leave: Are 26 days annually.

 PERFORMANCE MANAGEMENT

       Are employees clear about what is expected of them in their work
        roles?

                    YES (  )                           NO (    )

       ANS: When the employees are recruited in the company at the very same time
               they are told and informed about what are their duties, responsibilities,
               the working environments prevailing and the expectations of the
               organization at which they have to stand.

       Are employees clear about what is expected of them in their work
        roles?

                    YES (  )                           NO (    )

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

       ANS: When the employees are recruited in the company at the very same time
              they are told and informed about what are their duties, responsibilities,
              the working environments prevailing and the expectations of the
              organization at which they have to stand.

       Is quality and quantity of work evaluated?

                   YES (  )                           NO (    )

       ANS: The work fulfillment, whether the employee is completing his work on
              time and effectively is observed. There is no formal method of
              evaluation.

       Is there a system for performance evaluation?

                   YES (  )                           NO (    )

       ANS: For performance evaluation there is no such specific method.
              Performance appraisal of employee is done once at the year ending and
              that the subordinates rates their superior and the superior rates their
              subordinated and both of their rating s are reviewed by the superior of
              their both.

      Is performance tied to compensation?

                   YES (  )                           NO (    )

       ANS: If the performance of the employee is up to the mark then the AIL gives
              the employee an increment and also sometimes awards are given for
              good performance to motivate the employees.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

   Is there any poor work performance policy in the company?

                 YES (   )                    NO (  )

     ANS: There is no such policy in the AIL for the poor work performance of the
            employee in the company.

   Is there any performance appraisal policy and procedure?

                 YES (   )                    NO (  )

     ANS: There is no performance appraisal policy in the company but the
            company does have a procedure of the performance appraisal. The
            performance appraisal takes place once at the end of the year.

 COMPENSATION –

     All cash payments to employees and also the systems by which positions are
 evaluated, salary and wage ranges and bands are determined, and adjustments are
 made, including commissions, lump sum payments, incentive payments, and
 bonuses.

   Is there a formal pay structure?

                 YES (  )                          NO (   )

     ANS: The Board of Directors are to be provided with the Salary of Rs.85,000/-
            per month with power to make an annual increment area under

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

            discussion to a maximum amount of Rs.1,50,000/-per month in respect
            of salary and privilege up to 100% of salary. For the employees the pay
            structure is decided when they are recruited that what will be their pay.
            Salary is usually paid in the first week of every month. Salary officer
            prepare covers with the name and personal code No., of employees and
            the pay slip along with cash or cheque as per grade.

   Are compensation levels monitored and reviewed?

                 YES (    )                    NO (  )

    ANS: In AIL the compensation structure is not reviewed regularly. The
            compensation structure is reviewed once in a year.

   Is working time documented?

                 YES (  )                           NO (    )

    ANS: When an employee whether he is manager or an employee or a contract
            employee they have to fill up the register, where the timing of their
            entrance and exit is noticed.

   Are paid time off (vacation, holidays, etc) structures developed?

                 YES (  )                           NO (    )

    ANS: The Paid Holiday, Sick Leave, Casual Leave, Privilege Leave all these
            leaves and holidays are calculated by the company and records of
            these leaves/holidays of each and every employee is recorded and
            maintained.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

   Is the compensation plan communicated to all employees?

                 YES (   )                    NO (  )

    ANS: The Company does not communicate the compensation plan to its
            employees.

   Is contact made with medical providers?

                 YES (  )                           NO (   )

    ANS: Whenever and wherever necessary the company contacts the hospitals
            or medical providers if any emergency.

   Are injuries/incidents investigated?

                 YES (  )                           NO (   )

    ANS: If any accident is occurred in the AIL and the employee is injured then
            there is a complete investigation done of the incident held and then
            according to the injuries caused to the employee the employee is given
            compensation.

   Is follow-up remediation performed where appropriate?

                 YES (  )                           NO (   )

    ANS: Whether the incident is small or big the employee who is injured is
            rushed for the First Aid to ensure employees safety. There is an
            emergency Van in the company which is kept for any emergency
            purpose also the First Aid is kept in the company.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

      Are insurance premiums reviewed on a periodic basis?

                 YES (  )                            NO (   )

      ANS: The AIL gives insurance to each and every employee except to those
             employees who come under ESIC. Those employees are insured by the
             government. As the employees under ESIC gets all kind of benefits.

     Is the workplace environment maintained with safety in mind?

                 YES (  )                            NO (   )

      ANS: The Company has kept in mind the safety of the employees. So there is
             71 points to avoid fire hazard and emergency exit also.

   Are compensatory administrative costs included in the budget?

                 YES (    )                    NO (  )

      ANS: There is no compensatory cost included in the budget by the company
            as there is no compensatory policy decided by the company.

 LABOR RELATIONS & EMPLOYEE RELATIONS –
      The role of the human resources role in the relationship between the
 Organization and any bargaining unit of an employee-organized labor group,
 including labor-organizing campaigns. The formal policies and procedures
 governing all conditions of employment, including specific human resources
 activities not otherwise categorized.

   Is there a positive climate in your work area where employees are
    motivated in their work?

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                 YES (  )                           NO (    )

    ANS: In AIL each and every employee in every department is of friendly nature.
           Some likes and dislikes exist but still everyone work together and enjoy
           their work and creates positive environment around them.

   Does the company have union?

                 YES (   )                    NO (  )

    ANS: The AARTI INDUSTRIES do not have any union.

   Is there any grievances solving procedure?

                 YES (  )                           NO (    )

    ANS: The AIL has a unique way for solving the grievance. If any of the
           employees has any grievances then they can straight away meet the
           Managing Director of the company and tell him the problems and the
           Managing Director will try to solve the problem.

   Are the communication channels between management and employees
    in your work area sufficiently consultative so that disputes are avoided
    and effective problem solving is fostered?

                 YES (  )                           NO (    )

    ANS: Whether the dispute is small or big the employee can go to the Managing
           Director with their disputes and he will help in solving the disputes.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

   Are you comfortable working with the companies disciplinary measures
    and grievance procedures?

                 YES (  )                          NO (    )

    ANS: When asked this question to the Human Resource manger he said that
            the employees in the company including him all are satisfied with this
            type of Grievance solving procedure as the Managing Director is very
            cooperative.

   Are workplace policies flexible?

                 YES (   )                    NO (  )

    ANS: There is no as work place policy exist in AIL. Except the objectives, rules
            and regulations of the company which have to be maintained with
            proper discipline by each and every employee of the company.

     Are disciplinary actions for violating workplace policies flexible?

                 YES (   )                    NO (  )

    ANS: There is no such kind of policy so no disciplinary actions are taken.

   Is there a process for employees to lodge complaints?

                 YES (  )                          NO (    )

    ANS: The employee can either complain to their department head or can meet
            the Managing Directors for their problems and complaints.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

   Are there a variety of individuals to whom employees may lodge
    complaints (supervisor, HR representative)?

                   YES (   )                    NO (  )

     ANS: There is no such procedure where the employee may lodge complaints
             to their superior, supervisor, or HR manager. The Managing Director is
             contacted directly by the employees.

 DIVERSITY AND EQUAL EMPLOYMENT OPPORTUNITY
     Developing and implementing workforce programs to maximize employment of
 productive people with different characteristics, qualifications, and talents while
 recognizing the legal requirements and social responsibilities of equal treatment for
 all employees and the actions necessary to ensure those requirements are met.

   Do all your employees receive fair and equitable treatment?

                  YES (  )                           NO (    )

     ANS: Yes each and every employee in the company is fairly treated whether
             the employee is the worker or the manager.

   Are supervisors and managers trained in anti-discriminatory practices?

                  YES (  )                           NO (    )

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

     ANS: The employees are given seminars and lectures where they are made
             understood that what should be their behaviour towards the other
             employees in the company and that do not discriminate among worker
             or a manager. Every one in the company should be equally treated.

   Are employment practices in line with the various anti-discrimination
     laws?

                  YES (  )                            NO (   )

     ANS: There is no discrimination done in AIL among anyone. And there a notice
             kept that the anti-discriminative laws are not violated by any of the
             employees.

 EMPLOYEE BENEFITS

     Some organizations provide a range of employee benefits not prescribed by
 legislation or awards. These can relate to such matters as employee health, or
 assisting employees to balance work and family responsibilities. It is important to
 clarify how such benefits are awarded to employees in an organization policy in
 order to ensure that all employees know of their availability, they are distributed
 fairly, and that any conditions applying are understood.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

      Employee benefits, which fall into this category, may include: company cars,
 mobile phones, employee assistance programs, salary packaging, career breaks,
 and working from home and study assistance.

      The noncash compensation provided to employees of the Organization
 including, but not limited to, such components as insurances, retirement saving
 plans, and paid time off, and the systems, support services, and communications to
 successfully deliver the benefits.

   Does the company provide the employees with Insurance benefits?

                  YES (  )                             NO (   )

      ANS: Yes. AIL being a chemical company provides each and every employees
              with the insurance benefits. The employees coming under ESIC are not
              given insurance benefits.

   Does the company provide the employees retirement saving plans?

                  YES (  )                             NO (   )

      ANS: The aged employees who are working in AIL since years and are to be
              retired in few years are given retirement saving plan.

     Does the company provide the employees with the loan facilities?

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                  YES (  )                           NO (    )

     ANS: The Company gives loans to its employees. There is no limit of loan
             provided to the employees. If the employee need loan to build own
             house, car etc. also for the employee’s parents the loan is given to
             build house, education loans for the employee’s children are also
             given.

 SAFETY AND ENVIRONMENT –

     Audit practices will vary considerably among companies when considering
 factors that contribute to a safe work environment. A company may choose to
 develop an audit sheet tailored to a particular issue, such as the company’s zero-
 tolerance policy for harassment. In truly safe work environments, employees feel
 confident that they have a place to go when they have work-related problems. They
 model the behavior and communicate relevant procedures and resources so that
 everyone feels comfort-able and safe. An open-door policy is well worth the effort of
 writing and then providing training to managers and supervisors regarding how to
 deal with employees who may come to them with concerns The training,
 communication, and leadership required to provide a safe working environment; to
 provide an appropriate level of employee involvement and responsibility for
 implementing safe practices, using safety equipment, and complying with
 Organization safety rules and practices; and to ensure that federal, state, and local
 safety and environmental requirements are met.

   Is there any non-smoking policy?

                  YES (  )                           NO (    )

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

    ANS: There is a non smoking policy for all the employees and no employees
           should smoke in the premises of the organization and anyone found
           violating those rules will be punished and severe actions will be taken
           on them.

   Do employees participate in regular safety and health training programs?

                 YES (  )                         NO (   )

    ANS: All the employees are previously informed about the date and time at
           which training is to be held. Every employee has to participate in the
           training it is held every week. The schedule is listed every month.

   Are workplace accidents, near-misses, injuries, and illnesses reported
    and investigated?

                 YES (  )                         NO (   )

    ANS: Yes if there are any mishaps then they are to be straight away reported
           to the senior management and they investigate the accident properly
           and the employee is rushed to the hospital without delay.

   Are measures in place to prevent thieves from entering the grounds or
    buildings?

                 YES (  )                         NO (   )

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

    ANS: There is a tight security in the premises of the AIL. The security in charge
            takes care that there is no theft or robbery that takes place in the
            company and there are 6-7 security in charge (people) remain at night
            in the company premises.

   Is bright, effective lighting installed indoors and outdoors?

                 YES (  )                            NO (   )

    ANS: The AIL has set up good lighting facility in the premises. There is
            lighting at each place and there is no dark place this is to avoid working
            accidents of employee working at the night time.

   Are measures in place (access badges, traffic control, etc.) to keep
    unauthorized persons from entering the facility through normal
    entrances?

                 YES (  )                            NO (   )

    ANS: Through the normal entrance only authorized people are allowed to
            enter. The truck drivers have to show the identity card given by the
            company at the entrance. The visitors are asked the person to meet and
            then conformation is done from that employee and then the visitor is
            allowed in the company.

   Is there a reliable response system in place in the event an alarm is
    triggered?

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                 YES (  )                         NO (   )

    ANS: In the situation of an emergency an alarms is rung and then all the
           employees are asked to vacate that particular area and reach at a safer
           place. If there is a fire then the nearest fire point is switched on.

   Are employees encouraged to promptly report incidents, and suggest
    ways to reduce or eliminate risks?

                 YES (  )                         NO (   )

    ANS: The employees are previously educated that they should be careful while
           working with the chemicals and that they should wear proper safety
           equipment like gumboots, helmet and gloves (if necessary). All this
           things can avoid accidents in the company.

   Do you maintain OSHA?

                 YES (  )                         NO (   )

    ANS: The Company does maintain OSHA. This is for the safety of the
           organization as well as of the employees.

   From how many years?

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

     ANS: OSHA is maintained in AIL since its commencement of the company.

 DOCUMENTATION AND INFORMATION SYSTEMS –

     Preparing, storing, and maintaining employee records and information,
 including computerized human resources information systems, and meeting federal,
 state, and local requirements

   When operational changes are introduced into your work area do you
     take into consideration the impact on employees?

                  YES (  )                        NO (   )

     ANS: As AIL is very much concerned about its employees the company while
             making any policy or decisions keep in mind their employees safety
             and employee welfare.

   Are documents regarding employees kept for their required duration?

                  YES (  )                        NO (   )

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

      ANS: The AIL keeps and maintains each and every legal documents with them
              regarding their employees and the company itself. As whenever it may
              be needed they can show them (auditor’s visits).

 FORMS
     Factory act half yearly returns.
     Annual return
     Renual of LIC
     Notice of accident
     Report on accident
     Minimum wage act annual returns
     Payment of wage act annual
     ESIC reports
     Bonus act annual returns
     Provident fund monthly returns

      All these are the list of forms which the AIL always keep with them and they are
 properly maintained. As these forms are required any time and asked by the
 auditors of the company.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                          LIMITATIONS
 The limitations are as follows:

      I did not have complete knowledge about the different policies of the
       government that are set for the betterment of the employees which the
       companies should follow.

      There was some biasness in response of the HR manager towards his
       company.

      The company could not disclose much of the confidential matters of their
       policies and procedures.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                                FINDINGS
 The findings are as follows.

      The objective and purpose of the department and the organization should
       match and in case of AIL also it matches.

      As per the company’s act the companies should have an HR manual which
       the AIL does not have.

      The employee turnover ratio in the company is high. Which the company
       should take in notice and keep a proper record of it.

       The company has good recruitment and selection procedures for the
       selection of the candidates.

      The training given as per schedule to the employees.

      As per the company’s act the company should have a job description of each
       and every employees which is not proper in the AIL.

      Employee development is only by training and not by transfers.

      The performance management system is not properly managed. The
       employees are appraised once in a year.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

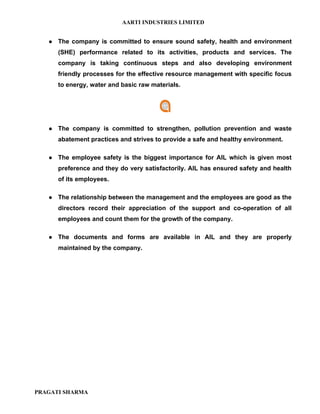

      The company is committed to ensure sound safety, health and environment
       (SHE) performance related to its activities, products and services. The
       company is taking continuous steps and also developing environment
       friendly processes for the effective resource management with specific focus
       to energy, water and basic raw materials.

      The company is committed to strengthen, pollution prevention and waste
       abatement practices and strives to provide a safe and healthy environment.

      The employee safety is the biggest importance for AIL which is given most
       preference and they do very satisfactorily. AIL has ensured safety and health
       of its employees.

      The relationship between the management and the employees are good as the
       directors record their appreciation of the support and co-operation of all
       employees and count them for the growth of the company.

      The documents and forms are available in AIL and they are properly
       maintained by the company.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                 RECOMMENDATIONS
     The AIL does not have any HR employee manual.         So AIL should maintain
      manuals covering all policies

     Job descriptions exists in AIL but they are not reviewed regularly. AIL should
      concentrate on reviewing those policies as for a new positions job descriptions
      should be readily available at the time of induction training given to the new
      employees.

     Though the turnover rates of employee are not high the company should
      monitor and keep a proper record of the turnover of employees.

     AIL should set up an appropriate performance appraisal policy and procedure
      once in 3-4 months to ensure that all employees understand their job
      responsibilities and objectives.

     The compensation levels should be monitored and reviewed regularly by the
      AIL. AS PER THE COMPENSATION ACT 1956 the company should review their
      compensation levels regularly

     AIL does not have any policy for the employee violating the regulations and
      policies of the company. So the company should develop some disciplinary
      policy to avoid violation of rules & regulations.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

     There should be a grievance solving procedure in which the employees can
      lodge complain or grievance to their superior or HR Manager.

     The AIL should provide the employees with transportation facilities. For the
      employees convenience.

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                        BIBLIOGRAPHY
    •   KOTLER KELLER, MARKETING MANAGEMENT
        PRENTICE HALL, NEW DELHI, 12TH EDITION 2006

    •   ANNUAL REPORT OF THE COMPANY 2005-2006

    •   HUMAN RESOURCE MANAGEMENT
        K ASHWATHAPPA - 4TH EDITION

    •   WEB SITES

         o http://www.hraudit.inc

         o http://www.amanet.org/books

         o http://www.e-hresources.com

         o http://www.hr.uwa.edu.au

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

        o http://www.explorehr.org

        o http://www.jjkeller.com/resourcecenters/hr/home.htm

        o www.aartigroup.com

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

   AARTI INDUSTRIES LIMITED (HUMAN RESOURCE AUDIT)

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

COMPANY NAME- REGISERED AS: _________________________________________

               TRADING AS: ___________________________________________

COMPANIES URL- _____________________________________________________

NAME OF THE PERSON- _______________________________________________

DESIGNATION-_______________________________________________________

CONTACT- CELL NO: __________________________________________________

            EMAIL ID: ________________________________________________

ADDRESS OF THE COMPANY- _________________________________________

                          ___________________________________________

TYPE OF COMPANY- __________________________________________________

TOTAL NO OF EMPLOYEES- ___________________________________________

                        STAFF (_______________)

                        OPERATOR (___________)

                        CASUAL (______________)

                        CONTRACTOR (_________)

DEPARTMENT MISSION –

______________________________________________________________________

______________________________________________________________________

       The overall objective or purpose of the human resources department within
        the organization to the organization's overall mission is linked or not?

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                  YES (   )                      NO (    )

      Does the company have formal HR manual?

                  YES (   )                      NO (    )

      Are all he key policies covered in the manual?

                  YES (   )                      NO (    )

      Working hours of the employees? ____________________

      Overtime hours? ____________________

      What is the official retirement age? ________________

      Does the company offer education assistance to the employees children?

                  YES (   )                      NO (    )

      Does any employee work from home?

                  YES (   )                      NO (    )

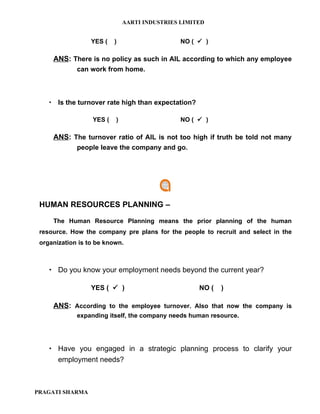

      Is the turnover rate high than expectation?

                  YES (   )                      NO (    )

 PLANNING-

      Do you know your employment needs beyond the current year?

                  YES (   )                      NO (    )

      Have you engaged in a strategic planning process to clarify your staffing
       needs?

                  YES (   )                      NO (    )

 STAFF DEVELOPMENT

      Do you have a way to identify the employees development needs of your
       employees? ( e.g. surveys, reviews, performance management)

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                       YES (   )                       NO (   )

          Do employees in your work area get the development they need to do their
           jobs effectively?

                       YES (   )                       NO (   )

          Do you monitor the results of employees’ development activities in order to
           assess their effectiveness?

                       YES (   )                       NO (   )

          Are new employees offered mentoring support?

                       YES (   )                       NO (   )

 RECRUITMENT AND SELECTION-

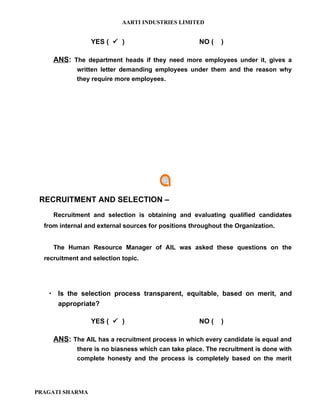

         Is the selection process transparent, equitable, based on merit, and
          appropriate?

                       YES (   )                       NO (   )

         Before filling a position do you identify the skills, qualifications and behaviours
          needed to meet your objectives?

                       YES (   )                       NO (   )

         Are new employees provided with a comprehensive induction?

                       YES (   )                       NO (   )

         Do job descriptions exist?

                       YES (   )                       NO (   )

         Are job descriptions up to date?

                       YES (   )                       NO (   )

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

     Are applicant references checked?

                  YES (   )                        NO (    )

     Are turnover rates monitored?

                  YES (   )                        NO (    )

     Is the selection procedure clearly told to the candidates?

                  YES (   )                        NO (    )

LEAVES -

     Total annual leaves _________________________

     Total sick leaves ____________________________

     Privilege leave __________________________________

EDUCATION, TRAINING, AND DEVELOPMENT –

     Do you provide performance or skills improvement training?

                  YES (   )                        NO (    )

     Do you utilize both internal and external resources for training?

                  YES (   )                        NO (    )

     Does the training include expertise in assessing education, and development
      needs?

                  YES (   )                        NO (    )

     Are seminars held in the company?

                  YES (   )                        NO (    )

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

     Do you offer employee in house training by the companies employees only?

                  YES (   )                     NO (     )

     Do you offer external training source?

                  YES (   )                     NO (     )

Benefits –

     Does the company provide the employees with Insurance benefits?

                  YES (   )                     NO (     )

     Does the company provide the employees retirement saving plans?

                  YES (   )                     NO (     )

     Dos the company provides the employees with the loan facilities?

                  YES (   )                     NO (     )

Compensation –

     Are compensation levels monitored and reviewed?

                  YES (   )                     NO (     )

     Is there a formal pay structure?

                  YES (   )                     NO (     )

     Is the compensation structured reviewed regularly?

                  YES (   )                     NO (     )

     Is working time documented?

                  YES (   )                     NO (     )

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

     Are paid time off (vacation, holidays, etc) structures developed?

                  YES (   )                       NO (   )

     Is the compensation plan communicated to all employees?

                  YES (   )                       NO (   )

     Are appropriate payroll withholdings performed?

                  YES (   )                       NO (   )

     Are injuries/incidents investigated?

                  YES (   )                       NO (   )

     Is follow-up remediation performed where appropriate?

                  YES (   )                       NO (   )

     Is contact made with medical providers?

                  YES (   )                       NO (   )

     Are insurance premiums and competitive quotes reviewed on a periodic basis?

                  YES (   )                       NO (   )

     Is the workplace environment maintained with safety in mind?

                  YES (   )                       NO (   )

     Is bonus given annually?

                  YES (   )                       NO (   )

     Are compensatory administrative costs included in the budget?

                  YES (   )                       NO (   )

DIVERSITY AND EQUAL EMPLOYMENT OPPORTUNITY –

     Do all your employees receive fair and equitable treatment?

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

                  YES (   )                        NO (   )

     Are supervisors and managers trained in anti-discriminatory practices?

                  YES (   )                        NO (   )

     Are employment practices in line with the various anti-discrimination laws?

                  YES (   )                        NO (   )

PERFORMANCE MANAGEMENT

     Are probationary employees appraised regularly?

                  YES (   )                        NO (   )

     Are employees clear about what is expected of them in their work roles?

                  YES (   )                        NO (   )

     Do employees have access to support and assistance for improvement if their
      performance is less than expected?

                  YES (   )                        NO (   )

     Is there a system for performance evaluation?

                  YES (   )                        NO (   )

     Does the system check for effectiveness of the evaluation?

                  YES (   )                        NO (   )

     Is quality and quantity of work evaluated?

                  YES (   )                        NO (   )

     Is performance tied to compensation?

                  YES (   )                        NO (   )

     Is there any poor work performance policy in the company?

                  YES (   )                        NO (   )

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

     Is there any performance appraisal policy and procedure?

                   YES (   )                       NO (   )

EMPLOYEE RELATIONS

     Is there a positive climate in your work area where employees are motivated in
      their work?

                   YES (   )                       NO (   )

     Does the company have union?

                   YES (   )                       NO (   )

     Is there any grievances solving procedure?

                   YES (   )                       NO (   )

     Are the communication channels between management and employees in your
      work area sufficiently consultative so that disputes are avoided and effective
      problem solving is fostered?

                   YES (   )                       NO (   )

     Are you comfortable working with the companies disciplinary measures and
      grievance procedures?

                   YES (   )                       NO (   )

     Are workplace policies flexible?

                   YES (   )                       NO (   )

     Are disciplinary actions for violating workplace policies flexible?

                   YES (   )                       NO (   )

     Is there a process for employees to lodge complaints?

                   YES (   )                       NO (   )

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

     Are there a variety of individuals to whom employees may lodge complaints
      (supervisor, HR representative)?

                   YES (   )                       NO (   )

SAFETY AND ENVIRONMENT –

     Is there any non-smoking policy?

                   YES (   )                       NO (   )

     Do employees participate in regular safety and health training programs?

                   YES (   )                       NO (   )

     Are workplace accidents, near-misses, injuries, and illnesses reported and
      investigated?

                   YES (   )                       NO (   )

     Are measures in place to prevent thieves from entering the grounds or
      buildings?

                   YES (   )                       NO (   )

     Is bright, effective lighting installed indoors and outdoors?

                   YES (   )                       NO (   )

     Are measures in place (access badges, traffic control, etc.) to keep
      unauthorized persons from entering the facility through normal entrances?

                   YES (   )                       NO (   )

     Is there a reliable response system in place in the event an alarm is triggered?

                   YES (   )                       NO (   )

PRAGATI SHARMA
AARTI INDUSTRIES LIMITED

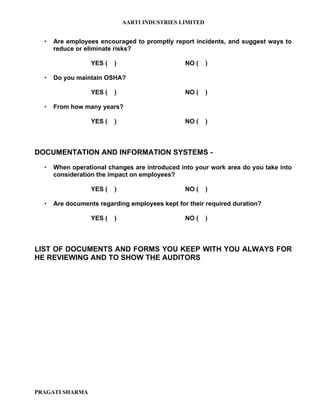

     Are employees encouraged to promptly report incidents, and suggest ways to
      reduce or eliminate risks?

                  YES (   )                     NO (     )

     Do you maintain OSHA?

                  YES (   )                     NO (     )

     From how many years?

                  YES (   )                     NO (     )

DOCUMENTATION AND INFORMATION SYSTEMS -

     When operational changes are introduced into your work area do you take into
      consideration the impact on employees?

                  YES (   )                     NO (     )

     Are documents regarding employees kept for their required duration?

                  YES (   )                     NO (     )

LIST OF DOCUMENTS AND FORMS YOU KEEP WITH YOU ALWAYS FOR
HE REVIEWING AND TO SHOW THE AUDITORS

PRAGATI SHARMA

Pragati sharma

  • 1.
    A SUMMER TRAINING & PROJECT REPORT ON “HUMAN RESOURCE AUDITING ” FOR AARTI INDUSTRIES LIMITED In the partial fulfillment of the requirement for M.B.A (Full Time) Submitted By SHARMA PRAGATI SUSHIL (M.B.A.) DIV A ROLL NO 50 Submitted To PROF. JAYSHRI TAYLOR (Internal Guide) MR. KIRIT SASHTRI (External Guide) G.I.D.C. RAJJU SHROFF ROFEL INSTITUTE OF MANAGEMENT STUDIES, GRIMS, Vapi AFFILIATED WITH VEER NARMADA SOUTH GUJARAT UNIVERSITY, SURAT ACADEMIC YEAR 2007-08
  • 2.
    AARTI INDUSTRIES LIMITED DECLARATION I, SHARMA PRAGATI SUSHIL hereby declare that the report on summer training and project work entitled “HUMAN RESOURCE AUDITING” submitted to ‘GIDC Rajju Shroff Rofel Institute of Management Studies” is a result of my own work and my gratitude to other work publications if any, have been duly acknowledged. PLACE: VAPI DATE: SHARMA PRAGATI PRAGATI SHARMA
  • 3.
    AARTI INDUSTRIES LIMITED ACKNOWLEDGEMENT “Turning aspirations into realities is easier when quality people are support of ones efforts” I greatly concede the help provided by the company and the people working for providing the much valuable information and also extend my thanks for the support throughout the project report. I am also thankful and acknowledge my depth gratitude to my teachers and the director of GRIMS Dr. S.S.SHAH for his constant encouragement and direction in the completion of this project report. I am obliged to him and express gratitude to him for giving me a great opportunity for the preparation of the project report. I would like to express my heartful of gratefulness to Mr. Kirit Shastri for having given me this opportunity to do a project in this esteemed organization. I am also thankful and concede my depth of gratitude to my professor guide Mrs Jayshri Taylor for her constant encouragement and supervision in the completion of this training and the project. PRAGATI SHARMA PRAGATI SHARMA
  • 4.
    AARTI INDUSTRIES LIMITED CERTIFICATE This is to certify that Ms. PRAGATI SHARMA has satisfactorily completed the work entitled, “SUMMER TRAINING PROJECT” specialization topic “HUMAN RESOURCE AUDITING”. Based on the declaration made by the candidate and my association as a guide for carrying out this work, I recommended this project report for evaluation as a part of the MBA Programme of Veer Narmad South Gujarat University. Date: 09/08/2007 Place: Vapi ___________________ (Guided By: JAYSHRI TAYLOR) __________________ (Director) Dr. R. S. shah PRAGATI SHARMA
  • 5.
    AARTI INDUSTRIES LIMITED EXECUTIVE SUMMARY The summer training report contains the detail of employees of AIL about their living status and other problem faced by there in there day to day life. Than what is CSR a small idea about that by theoretical as well as from companies point of view. The report starts with introduction of the Indian Chemical Industry with the history of the AARTI INDUSTRIES LIMITES. The goals, mission and vision are also added. Than what is CSR a small idea about that by theoretical as well as from companies point of view. The finance department is covered every necessary information. The marketing department of the company was in Mumbai so we were not able to get complete information about the marketing department of the company. The production department has in it all the production details with the production process and the ETP plant which is situated in the company and owned by the company. The specialization project undertaken was in accordance to the Human Resource Department of the organization to know the working of the department in organization. PRAGATI SHARMA
  • 6.
    AARTI INDUSTRIES LIMITED The Human Resource Auditing was basically done to know the working, systems policies and the procedures that are prevailing in the department of the organization. The methodology adopted for the completion of the project was to approach the Human Resource manager with a set of questionnaire. The data gathered shows that the AARTI INDUSTRIES LIMITED is having a good human resource department. The report contains the introduction of the Auditing. What does Audit contains? Why should Auditing be conducted? The analysis is done with the help of the questions asked and the response from the Human Resource Manager of the AIL. Then the findings are being shown. Lastly the suggestions are given to the company after the interpretation of the response of the Human Resource Manager. PRAGATI SHARMA
  • 7.
    AARTI INDUSTRIES LIMITED INDEX PART 1 (ALL DEPARTMENT) SR. NO TOPIC PAGE NO 1 THE STRUCTURE OF THE CHEMICAL 1-2 INDUSTRY 2 AARTI INDUSTRIES LIMITED 3-15  CORPORATE INFORMATION 3-5  INTRODUCTION 6-10  THE COMPETITIVE ADVANTAGE OF 11 AARTI INDUSTREIS LIMITED 3 HUMAN RESOURCE DEPARTMENT 16-60  RECRUITMENT 19-24  SELECTION 25-27  PROMOTION AND TRANSFER 28-30  TRAINING AND DEVELOPMENT 31-32  REMUNERATION 33-38  PERFORMANCE APPRAISAL 42-45  MEDICLAIM POLICY 48-49  SOCIAL RESPONSIBILITY 50-60 o (CSR) 56-60 PRAGATI SHARMA
  • 8.
    AARTI INDUSTRIES LIMITED 4 FINANCE DEPARTMENT 61-81  INTRODUCTION 61-64  STRUCTURE OF FINANCE DEPARTMENT 65  BALANCE SHEET 70  PROFIT & LOSS A/C 71  RATIO ANALYSIS 72-76  SHAREHOLDING PATTERN 77-78  CHARTS 79-81 5 MARKETING DEPARTMENT 82-122  INTRODUCTION 82-86  STRUCTURE OF MARKETING 87 DEPARTMENT  THE HOLISTIC MARKETING APPROACH 88-90 SR. NO TOPIC PAGE NO  THE MARKETING MIX 94-114 o PRODUCT 95-103 o PRICE 104-107 o PLACE 108-113 o PROMOTION 114  PACKAING, LABELLING, WARRANTIES 115-120 AND GUARANTEES.  THE DISTRIBUTION CHANNEL 121  MODE OF TRANSPORTATION 122 6 DESPATCH DEPARTMENT 123-125 PRAGATI SHARMA
  • 9.
    AARTI INDUSTRIES LIMITED 7 PRODUCTION DEPARTMENT 126-  INTRODUCTION 126-127  PLANT LAYOUT 128-129  PRODUCTION PROCESS 130-133  PRODUCTS 134-142  QUALITY CONTROL 143-147 8 RESEARCH & DEVELOPMENT DEPARTMENT 148-149 9 STORES DEPARTMENT 150 10 PLANT UTILITY DEPARTMENT 151-153 11 HEALTH AND SAFETY 154-156  AARTI HEALTH CARE 155-156  SAFETY DEPARTMENT 157-165  SHE POLICY 166-168 12 PROCESS OF HANDLING HAZARIOUS CHEMS 169-170 13 MAINTENANCE DEPARTMENT 171-172 14 EFFLUENT TREATMENT PLANT 173-177 15 SWOT ANALYSIS 178-179 16 ANNEXURE 17 BIBLIOGRAPHY AARTI PRAGATI SHARMA
  • 10.
    AARTI INDUSTRIES LIMITED INDUSTRIES LIMITED THE RIGHT CHEMESTRY FOR A BRIGHTER TOMORROW THE STRUCTURE OF THE CHEMICAL INDUSTRY PRAGATI SHARMA
  • 11.
    AARTI INDUSTRIES LIMITED In tune with the fast changing economic environment in the country, the Indian chemical industry too is on a steady growth path. Indian chemical industries has a strong and diversified base encompassing many areas such as organic and inorganic chemicals, plastic, fibers, dye stuffs, paints, pesticides, insecticides, speciality chemicals, drugs and pharmaceuticals. The growth in this sector has constantly been increasing than the average growth rate of the manufacturing sector in India. The chemical industry is sometimes referred to as the "keystone" industry because of the way the rest of the manufacturing sector relies on chemicals. Chemicals are nearly a $1.5 trillion global enterprise, and the U.S. chemical industry is the world's largest producer. The chemical industry is also the second largest consumer of energy in manufacturing and spends over $5 billion annually on pollution abatement. Chemical industry has 21% of total energy consumption. The Indian economy is firmly on the path of the steady growth. Even during the last decade when the other countries were in the grip of the massive slowdown, India continued to enjoy a comfortable position. This recent spurt in the growth is propelled by radical reforms such as the removal of the restrictions on foreign investment and industrial delicensing. With substantial increase in the domestic Gross Domestic Product (GDP) rate; the growth is also translated into increasing the demand in the domestic sector in various chemicals. Simultaneously the chemicals sector also shows growth in export. THE INDIAN CHEMICAL INDUSTRY SIZE US $ 28 BILLION Knowledge 18% Basic Speciality 57% 25%  Chemical Industry is an important constituent of the Indian economy.  Its size is estimated at around US $ 28 billion approx, which is equivalent to about 7% of India’s GDP. PRAGATI SHARMA
  • 12.
    AARTI INDUSTRIES LIMITED  In terms of volume, it is 12th largest in the world, and 3rd largest in Asia.  Within India, it constitutes about 15% of manufacturing capacity and 20% of the Excise revenue to the Government of India.  Chemical industry has weight age of about 13% in the index of industrial production.  The global chemical industry is valued at about US $ 1.7 trillion. Of which, India’s chemical sector accounts for just 2%. {The Indian chemical industry is the 12th largest in the World and 3rd largest in Asia. The Indian chemical industry constitutes 12.5% of the country’s industrial production and 15%of the manufacturing capacity of India. Also the chemical industry constitutes 6.7% to India’s GDP.} India’s Chemical Industry Export  India’s chemical exports have recorded growth rate of 9%.  For the year 2001-02, the chemical industry accounted for more than 16.20% of the total Indian exports.  For the year 2001-2002 exports of all chemicals and allied products were US $ 4684 million. PRAGATI SHARMA
  • 13.
    AARTI INDUSTRIES LIMITED CORPORATE INFORMATION ∗ Name of the Company : AARTI INDUSTRIES LIMITED ∗ Type of Company: Public Limited ∗ Established Year : 1984 ∗ Size of Company: Large Scale ∗ Plants :  Plot no. 801,801/23, 802,803/1-2-3, GIDC, Phase 3, Vapi-396195  Plot no. 902, GIDC ESTATE, PHASE 2, VAPI-396195, DIST: VALSAD, GUJARAT.  Plot no. 752-753-754 SARIGAM, TAL: UMARGOAN, DIST: VALSAD, GUJARAT  Plot no.758/1, 758/2, GIDC ESTATE JHAGADIA, DIST: BHARUCH, GUJARAT  Plot no. K-18, MIDC, TARAPUR, DIST: THANE, MAHARASHTRA. PRAGATI SHARMA
  • 14.
    AARTI INDUSTRIES LIMITED  Plot no. E-50, MIDC, TARAPUR, DIST: THANE, ∗ REGISTERED OFFICE: Plot no.801, 801/23 GIDC ESTATE, PHASE-3, VAPI-396195, VALSAD ∗ CORPORATE OFFICE : Udyog Kshetra, 2nd floor, L.B.S.Marg, Mulund-Goregaon Link Road, Mulund (W), Mumbai-400 080 Man-Power Force ∗ Board of Directors Chandrakant V. Gogri Chairman Rajendra V. Gogri Vice-Chairman & Managing Director Shantilal T. Shah Vice-Chairman ∗ Independent Directors : Ramdas M. Gandhi Laxmichand K. Jain Vijay H. Patil Haresh K. Chheda ∗ Whole-time Directors : Parimal H. Desai Manoj M. Chheda Rashesh C.Gogri Hetal Gogri Gala Kirit R. Mehta PRAGATI SHARMA
  • 15.
    AARTI INDUSTRIES LIMITED ∗ Company Secretary Mohan P. Sonar ∗ Auditors M/s. Parikh Joshi & Kothare, 49/2341, M.H.B.Colony, Gandhi Nagar, Bandra (East), Mumbai-400 051 ∗ Registar & Transfer Agent :  Sharpro Services (India) Pvt.Ltd., Satam Estate, 3rd floor, above Bank of Baroda, Cardinal Gracious Road, Chakala, Andheri (E), Mumbai-400 099 ∗ Bankers:  Bank of Baroda  Union Bank of India  State Bank of India  ABN Amro Bank  Standard Chartered Bank  HDFC Bank Ltd.  Export-Import Bank of India  IDBI Bank Ltd.  City Bank N.A.  UTI Bank Ltd.  ICICI BANK LTD PRAGATI SHARMA
  • 16.
  • 17.
    AARTI INDUSTRIES LIMITED AARTI INDUSTRIES LIMITED In the business world, the only constant is change. Paradigms are remodelled, visions and business strategies modified, and technologies upgraded in response to the needs and challenges of a changing world. In other words, organizations have to change to survive, to remain competitive and to succeed. AARTI INDUSTRIES LIMITED (AIL) is a dynamic organization, continuously investing in innovative products and processes, as well as cleaner technologies, to meet shareholder aspirations and societal expectations. AARTI was started in the year 1984. The first unit of AARTI group, ALCHEMIE LABORATORIES, commenced commercial production of DIMETHYL SULPHATE (DMS) in the year 1975. Today, AARTI has acquired world-class expertise in the development and manufacturing of basic bulk chemicals, dyes & pigment intermediates, pharmaceuticals & agrochemicals along with their intermediates, rubber chemicals, surfactant intermediates and speciality chemicals. AARTI is amongst the largest producers of Benzene based basic and intermediate chemicals in India At AIL, they believe that the pursuit of corporate goals and commitment to social responsibilities have to go hand in hand. So, while the AIL are one of the largest producers of benzene-based intermediates in India and are ranked among the top five producers in the world, the AIL is also an organization alive to their responsibilities as a good corporate citizen. The people at AIL believe that high standards of business conduct are integral to earning the trust and respect of stakeholders and therefore have zero tolerance towards unethical behaviour or corruption in any of their business dealings. PRAGATI SHARMA
  • 18.
    AARTI INDUSTRIES LIMITED AIL is a multi-product, multi-location company manufacturing over 125 products at global-scale. AARTI has manufacturing sites at Gujarat, India (Vapi, Sarigam & Jhagadia) and at Maharashtra, India (Tarapur & Dombivli). The Tarapur facility of AIL’s API division. AARTI has attained a total turnover of US $ 189 million in the year April 2003- March 2004 with flagship companies AARTI INDUSTRIES LIMITED (AIL) & AARTI DRUGS LIMITED (ADL) listed on Stock Exchanges. AARTI has a Subsidiary AARTI HEALTHCARE LIMITED (AHCL), which is engaged in manufacturing of Active pharma ingredients ranging from Ace Inhibitors, Broncodialators to Steroids.Recognizing the importance of research, AARTI has established three full-fledged DSIR (Dept. of Scientific & Industrial Research)- Government of India recognized R & D centers, which carry innovative product and process development work. AARTI INDUSTRIES LTD. is an ISO 9002/GMP certified organization and a flagship company of the USD 259 million strong Aarti Group. AARTI has the privilege of catering to the requirements of leading manufacturers of dyes, pigments, pharmaceuticals, agrochemicals and rubber chemicals in countries such as USA, UK, Germany, Spain, Italy, Switzerland, Belgium, Japan, Korea, China, Russia, etc. AARTI also has representatives in USA & a subsidiary company in UK to provide better services to its Export Customer. For the people at AIL, sustainable growth is not an end-point, but an ongoing process and a life-time commitment. The dedication of AARTI INDUSTRIES LIMITED to the principles of sustainability is best encapsulated in their company's motto - "The right chemistry for a better tomorrow". A better tomorrow for our children and future generation. PRAGATI SHARMA
  • 19.
    AARTI INDUSTRIES LIMITED AIL will always be a socially responsible company. The company AIL always value the active involvement of their people their mission of achieving sustainable growth. The company also thanks all of their shareholders, customers, business partners, as also the media, financial institutions, industrial associations, NGOs, government organizations, neighbouring industries and local communities for placing their trust in the company i.e. The AARTI INDUSTRIES LIMITED and being a part of this exciting journey of sustainable growth. At AIL, a sharp focus on the three main constituents of the "Triple Bottom Line"- economy, society, and environment – guides their activities towards greater sustainability. AARTI INDUSTRIES commitment to corporate social responsibility is corroborated by the company’s emphasis on creating a performance-based ambience for their people, their respect for human rights and labour welfare, their commitment to high ethical standards, their initiatives in the areas of health, education and environment preservation, and their endeavors to create value for the company’s stakeholders. Over the last two decades, we have acquired world-class expertise in the development and manufacturing of basic bulk chemicals, dyes & pigment intermediates, pharmaceuticals & agrochemicals along with their intermediates, rubber chemicals, surfactant intermediates and speciality chemicals. AIL’s API division, Aarti Healthcare, makes high-value lifestyle APIs which are used in manufacturing cardiovascular, antiasthmatic, anti-cancer, anti-thalassaemic, anti- hypertensive and anti-depressant drugs Exports account for over 40% of our total sales. At present, AIL export to more than 40 countries worldwide including USA, UK, Germany, Spain, Italy, Switzerland, Belgium, Japan, Korea, China and Russia. Over 60% of AIL’s exports are to developed countries, with more than 40% going to the EU. PRAGATI SHARMA
  • 20.
    AARTI INDUSTRIES LIMITED GOALS AARTI group is strategically placed to exploit growth opportunities in the Chemical Industry. In view of its technical expertise and broad base satisfied clientele in India and abroad, AARTI is looking for global partners and strategic alliances in areas of mutual interest viz. o Development of International markets for AARTI's products. o Toll manufacturing. o Transfer of Technology / Technical know-how. VISION STATEMENT We will be a world-class organization that enhanced value to our customers and other shareholders by o Caring for employee to work as motivated terms in open and learning environment. o Setting challenge new standards of performance. o Focusing on total quality, innovation and responsible care towards the environment. PRAGATI SHARMA

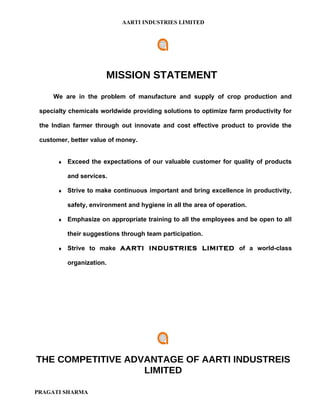

  • 21.
    AARTI INDUSTRIES LIMITED MISSION STATEMENT We are in the problem of manufacture and supply of crop production and specialty chemicals worldwide providing solutions to optimize farm productivity for the Indian farmer through out innovate and cost effective product to provide the customer, better value of money. ♦ Exceed the expectations of our valuable customer for quality of products and services. ♦ Strive to make continuous important and bring excellence in productivity, safety, environment and hygiene in all the area of operation. ♦ Emphasize on appropriate training to all the employees and be open to all their suggestions through team participation. ♦ Strive to make AARTI INDUSTRIES LIMITED of a world-class organization. THE COMPETITIVE ADVANTAGE OF AARTI INDUSTREIS LIMITED PRAGATI SHARMA
  • 22.
    AARTI INDUSTRIES LIMITED • The AARTI INDUSTRIES LIMITED (AIL) considers that their R&D is quite good which helps the industry in gaining the advantage compared to their competitors. • The people in the AIL’s R&D department keep on doing the research work continuously which helps them in gaining more advantage than that of their competitors i.e. reduction of the cost or increasing the quality of the product that are to be served to theirs customers. POSITION OF AARTI INDUSTRIES LIMITED (AIL) The manufacturing units of the AIL are of global scale and are mostly in the States of Gujarat and Maharashtra. Both the units are ISO / GMP certified. The plants are highly incorporated along with Cost-Efficient Manufacturing Process and Low capital investment and manufacturing more than 100 products. The AARTI INDUSTRIES LIMITED is ranked amongst top 5 Global manufacturers for their key product and their continuous R&D support and process improvement is the key for Company to remain competitive globally. PRAGATI SHARMA
  • 23.
    AARTI INDUSTRIES LIMITED SOME KEY FACTS ABOUT AIL • AARTI INDUSTRIES LIMITED is one of the largest producers of benzene-based basic and intermediate chemicals in India and among the top five globally. • AARTI INDUSTRIES LIMITED one of the top three producers of Dimethyl Sulphate in the world. • The AARTI INDUSTRIES LIMITED has a fully backward integrated plant for Dimethyl Sulphate, i.e., starting from Sulphur and Methanol. • AIL Rs.500 crore company manufacturing Organic chemical and Intermediates for Vapi unit. • AIL derives about 90 per cent of its revenues from specialty and basic chemicals. • Through its backward integration manufacturing, AARTI INDUSTRIES LIMITED acquires the competitive advantage with respect to the availability of raw materials and reduced cost. PRAGATI SHARMA
  • 24.
    AARTI INDUSTRIES LIMITED • AIL has the largest installed capacity of chloro-benzene (ONBC and PNBC) domestically. • The company is adding more fluorine based products in its portfolio. • The company has in recent times been focusing on specialty chemicals and pharmaceuticals. • AARTI INDUSTRIES LIMITED doubled its sales turnover in the last four years from Rs 345 crores in 2001-2002 to Rs 786 crores in 2005-2006 whereas exports increased more than three times during that period from Rs 101 crores in 2001-2002 to Rs 342 crores in 2005-2006. • AARTI INDUSTRIES LIMITED carries out custom synthesis activities and undertakes contract research & manufacturing. • AARTI INDUSTRIES LIMITED was been presented the star exporter award for 2004-05 by "The Gujarat Dyestuffs Manufacturers' Association" for earning the highest foreign exchange from direct export of self-manufactured dyes & dyes intermediates. This was one of a biggest reward to the AARTI INDUSTRIES LIMITED for their efficient effort. PRAGATI SHARMA
  • 25.
    AARTI INDUSTRIES LIMITED General Rules and Regulation These are the rules and regulations that the employees of AARTI INDUSTRIES LIMITED have to pursue stringently and the employees do follow all these rules and regulations happily for the betterment of their lives as well as the company. ♦ The Employees cannot bring any kind of unnecessary resources like matchboxes or cigarette, alcohol, tobacco, etc. ♦ The employee after entering the premises of the AIL should always put on his identity card with him. ♦ During functioning hours the employees should not meander any where, devoid of their work and wasting the time. ♦ While entering and departing out of the AARTI’s premises each and every employee should make an entry by means of purchasing card from the security office at the main gate of the AIL. ♦ Any employee of AIL should not remain missing or absent without former informing to his department head and P & A. Dept. unless and until the explanation of absent is bad health or any urgency that might have occurred. ♦ Every employee should be dressed in uniform that has been provided to them by the company while entering the premises of the AIL with the safety shoes, apron and safety helmet as per pre instructed to them. PRAGATI SHARMA
  • 26.
    AARTI INDUSTRIES LIMITED Company’s shared value: o Global capacities o Customer Satisfaction o Quality and logistics o Continuous cost control o High value addiction o Diversified product range o Loyal work force o In-house recognized R & D Centers. PRAGATI SHARMA
  • 27.
  • 28.
    AARTI INDUSTRIES LIMITED ORGANIZATION CHART Chairman Junior Director Vice President Mkt. Manager Director Work Personal Manager Excise Officer Dep. Gen. Manager Prod. Manager Personal Assistant G. M. Mkt. Officer Maint. Dept. Production Dept. Q.C. Dept. Dispatch Dept. Safety Dept. Security Dept. DGM Official A/c DGM Organic Div. Acid Div. DGM Dispatch Officer G. M. Security Off. Fin. Exe A/c Asst. Jun. Exe. GM GM Sen. Chemist Dispatch Assist. Safety Off. Security Asst. Technician DGM DGM Chemist Safety Asst. Supervisor Sen. Manager Sen. Manager Lab Assistant Engineer Security Guard Gun Man Manager Manager Supervisor SDM SDM Worker Dep. Manager Dep. Manager Worker Worker PRAGATI SHARMA
  • 29.
  • 30.
    AARTI INDUSTRIES LIMITED HUMAN RESOURCE DEPARTMENT Human Resource Management is that management which is related with decisions relating to planning organizing, directing and controlling of the procurement, development, compensation, integration, maintenance and separations of human resources to the end that individual, organization and sociality objectives are accomplished. And the same is done in the AIL. The objective of the AARTI INDUSTRIES LIMITED is the maintenance of those relationships on the basis of which organization can get maximum personal contribution from employees. As we all know that work of the Human Resource Department is of acquiring, retaining and maintaining the manpower. The same is in the case of the AARTI INDUSRTRIES LIMITED the organization tries its best to procure maintain and retain their employees in their organization. The Human Resource is important to any labour or capital intensive industries. So they should place an important position to an industry. The AARTI INDUSTRIES LIMITED regular undertakes the training activities and other HR initiatives. As the AIL does work for the societies, it also thinks about its employees. The company has also continued its scheme for assistance to employees with a view to ensure that their basic housing needs are fulfilled. The company has been continuously focusing. On people and processes those to encourage and realize their full potential through continuous on job learning and through other HRD initiatives coordinal and harmonious relation with employees continued to prevail through the year under assess. PRAGATI SHARMA
  • 31.
    AARTI INDUSTRIES LIMITED As it is aptly said that Human Resource is an asset for any organization for the success of any organization human resource play a significant role. If any company’s Human Resource is not up to the mark or efficient then it affects the performance of an organization. Each and every department is linked with another department. One department forms a stair for the other department in the same way the Human Resource play a vital role in each and every department whether it is finance department, marketing department, production/operation department, R & D department or any other. The manpower must be efficiently employed to get an effective result. Functions of Human Resource Manager: The following are main function of human resource manger in AARTI INDUSTRIES LIMITED: ∗ Application and control of company rules and organization policy. ∗ Recruitment of manpower intended by HOD and approved by management and top head. ∗ Employee and trainees induction programmed arrangement. ∗ Development of trainees by training and approvals ∗ Transport arrangement for required by employees, guests & customer. ∗ Booking and reservation as required by employees / guests. PRAGATI SHARMA
  • 32.
    AARTI INDUSTRIES LIMITED ∗ Safety of company material and employees. ∗ Maintenance of first aid material. ∗ Canteen administration ∗ Assistance of meeting and conference ∗ Company occasions arrangements like annual day, Picnic. ∗ Labor welfare activities as decided by management. ∗ Arrangement of uniform, shoes, seasonal wear, safety equipment. ∗ House keeping of company premises. ∗ Casual labor arrangement ∗ Building maintenance and office maintenance ∗ Public relation activities. ∗ Salary wages and perks administration works and recorded keeping. ∗ Telecom related activities ∗ Appraisal assistant of employee for increments , training, promotions ∗ Factory Act related activities ∗ Stationary planning and arrangement. PRAGATI SHARMA
  • 33.
    AARTI INDUSTRIES LIMITED RECRUITMENT Recruitment in simple terms is searching for capable applicants for the job. Recruitment is attracting and obtaining the eligible candidates so that the right people are selected for the job. Recruiting of the individuals or the recruitment process is one of the most vital and complicated part of an organization. If any error is made in the recruitment process, then in a straight way it could be seen in the work performance of the employees and the profits of the company as a single mistake will have an effect on the result of the organization. As AARTI INDUSTRIES LIMITED is producing some of the hazardous chemical so for them man power recruitment process is hard-hitting job. Recruitment is the generating of the application of applicants for specific position through many of the sources from them the three common sources are the advertisement, state employee exchange agencies or a private employment. According to AARTI INDUSTRIES LIMITED they formulate a selection policy, due consideration is to be given to organizational requirement as well as technical and professional dimension of selection procedure adopted by AARTI INDUSTRIES LIMITED and that it is tailor made to meet its particular needs. PRAGATI SHARMA
  • 34.
    AARTI INDUSTRIES LIMITED The thoroughness of the procedure depends upon three factors.  Nature of selection.  Policy of the company.  The length of the probability period or trial period. The company has also continued their schemes for assistance to employees with a view to ensure that there basic housing needs are fulfilled. The company has been continuously focusing. So they should place an important position to industries. The AIL company regular undertakes the training activities and other Human Resource initiatives. The Human Resource is important not only to any labor intensive but to the capital intensive industries also. On people and processes those to encourage and realize their full potential through continuous on job learning and through other HRD initiative cordial and harmonious relation with employee continued to prevail through the year under review. Human Resource plays a vital role in each and every department whether it is finance department, marketing department, production/operation department, R&D department or any other. In an organization the manpower must be efficiently used to make out the best from them. Human Resource is asset for any organization for the success of any organization. Human Resource plays an important role. If any company’s Human Resource is not a standard or not efficient then it affects the performance of an organization. PRAGATI SHARMA
  • 35.
    AARTI INDUSTRIES LIMITED Source of Recruitment : The sources that are used for the recruitment purpose in AARTI INDUSTRIES LIMITED are as follows: • Internal sources ∗ Transfer ∗ Promotion • External sources ∗ Advertisement ∗ Educational institution ∗ Labor contractors ∗ Recruitment agencies. PRAGATI SHARMA
  • 36.
    AARTI INDUSTRIES LIMITED RECRUITMENT PROCEDURE:- NEWSPAPER APPLICATION RECEIVING APPLICATION SORTING OUT APPLICATION WRITTEN TEST INTERVIEW SORT TEST FINALIZE INTERVIEW II INTERVIEW OFFER LETTER OFFER LETTER JOINING THE ORGANIZATION JOINING THE ORGANIZATION APPOINTMENT LETTER APPOINTMENT LETTER PRAGATI SHARMA
  • 37.
    AARTI INDUSTRIES LIMITED THE RECRUITMENT PROCESS The process of recruitment can be explained as under: NEWSPAPER APPLICATION: Very firstly the AIL gives the advertisement in the newspaper so that the applicants are attracted towards the advertisement and they apply in the company for the required post. In that newspaper advertisement the AIL gives the required qualification for the post. So that the applicants who are that qualified and capable only they apply for the job. RECEIVING APPLICATION: After the advertisement placed in the newspapers the AIL receives the application forms of those candidates who are willing for the job. SORTING OUT APPLICATIONS: After the applications being received by the AIL, they do the work of sorting out the applications. A panel is selected and those people in the panel do the work of sorting the received applications and then according to those panel members the candidates who are capable to go a step further i.e. for the interview are being selecte. Before the interview the AIL goes for a test for the candidates which is a written test in which the candidates are given a questionnaire in which the AIL ask few questions which has to be answered in a written form. After the test the answers are gone through and then the candidates whose answers are found to be interesting are further being called out for the interview. PRAGATI SHARMA
  • 38.
    AARTI INDUSTRIES LIMITED INTERVIEW: Then the interview is held. Some employees of the AIL from the executive level are being selected so that those people carry out the interview without any biasness. In the interview the employees of the AIL carries on with the question answer sessions. By this interview the panel gets a clear picture of which people are competent for the job and can go for the further process of the recruitment. FINALIZE: Finally the applicant who is found to be competent enough by the panel is being finalized after the finalization the employee is asked to go under a physical checkup under the doctors and submit the report in the AIL. OFFER OR APPOINTMENT LETTER: After all the procedures are completed and a clear chit given by the doctors the employees are being given an offer or an appointment letter to join the organization the candidate. PRAGATI SHARMA
  • 39.
    AARTI INDUSTRIES LIMITED SELECTION PROCEDURE APPLICATION FORM INTERVIEW PHYSICAL EXAMINATION REFERENCE FINAL APPROVAL EMPLOYMENT PRAGATI SHARMA
  • 40.
    AARTI INDUSTRIES LIMITED THE SELECTION PROCESS The selection is the process of making a choice or deciding on individuals from among many. The selection process is of selecting a well deserving, capable and competent candidate for the given job. The selection can be from within the organization as well as fresh candidate. If the filling of the job is to be done internally or from within the organization then it can be done by the promotion and transfers of the employees but if the filling of the job is via externally then it can be done through the recruitment and the selection procedure of the organization. APPLICATION FORM: The application form is given to the candidates and that the candidates are asked to fill them. The AIL is very much careful while going on with the selection process. The AIL not only selects the people from the external source but also from the internal source. INTERVIEW: The AARTI INDUSTRIES LIMITED after the receiving of the application form from the candidates the company goes for the interview. In the interview the AARTI INDUSTRIES LIMITED top level management sees to it that the process is carried out very properly and that the candidates are selected on the basis of their experience, compatibility, competence, and qualifications. The AIL keeps in mind that the candidates selected are experienced and that this is the most important criteria the AIL look at before selecting any of the candidates for their company. PRAGATI SHARMA
  • 41.
    AARTI INDUSTRIES LIMITED PHYSICAL EXAMINATION: The company after going on with the interview process some slot of candidates are selected and also that the selected candidates are being asked to go for the physical checkup as the physical checkup may help the AIL to know whether the candidates are completely healthy or not. The candidates are asked to submit a report of their fitness in the organization and then the further decisions are being taken by the organization. As the physical checkup may help the AIL to avoid future problems. REFERENCE CHECK: After the company carries out with the physical checkup of the selected employees, the company cross checks the reference. For a company reference check is one of the important criteria while selecting the candidate or while giving the employment to the applicant. FINAL APPROVAL: After the reference check is been completed the next step is to give approval to that candidate who has completely satisfied the AARTI INDUSTRIES LIMITED requirement of an employee. EMPLOYMENT: After the company has completed all their procedures now is the time to give the employment to the candidates who are selected by the organization for their company. PRAGATI SHARMA
  • 42.
    AARTI INDUSTRIES LIMITED PROMOTION AND TRANSFER PROMOTION AARTI INDUSTRIES LIMITED gives progression to its employees with enhanced pay, position and employment responsibility all the way through encouragement by promoting them as per the responsibility and the work done by the employees as one of the best way of expressing the employees excellent work is by promotion or by increasing the employee’s remunerations. PROMOTION CRITERIA The AARTI INDUSTRIES LIMITED has a promotion policy that, the promotion to the employees is given on the basis of seniority. AARTI INDUSTRIES LIMITED has resolute to give promotion after every two years of the working period of the employees. If an employee is not satisfied of the post he has, the employee is then sent back to his position for the duration of his promotion period. As per their resolution the AIL gives promotion to its employees by the way of their seniority which is 40% and out of 60%, 20% by the way of personal interview and 40% by performance appraisal so that none of the employees feel that they are been deceived by the company authority and the well deserved employee is being given the promotion. PRAGATI SHARMA
  • 43.
    AARTI INDUSTRIES LIMITED PROMOTION POLICY AARTI INDUSTRIES LIMITED has espoused the promotion policy as per the seniority as well as on the merit basis of the employees. The seniority of employee is regarded grade wise as per character residence period on the particular grade. Also the work done by the employees are given significance by the AIL. TRANSFERS As we all know that transfer is a cross shifting the employee as per the demand or a requirement of the employee, causing a movement of an employee from his/her one job, section, department shift, plant or position to another at some or another place with that particular departmental salary status and responsibility, etc. The Aarti Industries Limited follows a well define transfer policy to avoid any grievances among the employees. PRAGATI SHARMA
  • 44.
    AARTI INDUSTRIES LIMITED • Periodic Transfer In the AARTI INDUSTRIES LIMITED periodic type of transfers is mainly for those departments whose regional areas and sales department are located abroad or out the country. For that reason the marketing department is the only department which has the periodic transfer present in it. The AARTI INDUSTRIES LIMITED has a policy according to that policy the marketing personals are transferred every four year, so they can come back to the native state. There are no frequent transfers that exist n the company and they are avoided in company as the AIL are being concerned of the adverse effects of transfer on heir employees which is seen in the work of the employees. • Internal Transfer The internal and the departmental transfer are mostly avoided in the AARTI INDUSTRIES LIMITED. PRAGATI SHARMA
  • 45.
    AARTI INDUSTRIES LIMITED TRAINING AND DEVELOPMENT Training in AARTI INDUSTRIES LIMITED is given to those people who are newly employed in the company so as to make them familiar with the industry and the working condition prevailing in the company. The trainings that exist in AIL:- o Induction training o Health and safety o Discipline o TQM o ISO 9000 o Management development o To increase productivity. o To improve quality. Induction training: The induction training is given to those of the new employees to make them familiar with the company as well as the working of the organization. Discipline: The discipline refers to the rules and the regulations that prevail in the AARTI INDUSTRIES LIMITED. As the employees enter in the organization they are thought and made aware with those rules and regulations so that the employees do not violate those rules and that the discipline is maintained in the organization properly. PRAGATI SHARMA
  • 46.
    AARTI INDUSTRIES LIMITED Health and safety: The health and safety of the employees is of the utmost importance for the company and for that purpose the AIL gives the employees the instruction for their safety and the compulsory usage of the things which are used for the safety purpose e.g. gumboots, caps etc. so that the accidents are avoided and health and safety of people are more concentrated by the organization. So for that reason the organization motivates the employees for the occupational health, safety and environment, safety policy, philosophy, accident prevention techniques, safety procedure etc. The safety department conducts in plant safety training program on regular basis. • Chemical emergency, prevention preparedness and response. • Importance and use of safety equipment (Explosive, oxygen, CL-2, HCN, Monitors, SCBA, ESA, Fire Gas Tight Suit, First Aid-Box) Total Quality Management: (improving quality) Total Quality Management (TQM). The quality being the most important part of the product and it’s selling so for that reason the employees are thought of the quality management so that they understand the actual and good quality products and they make a quality product. As the quality gives the clear picture of the organization the AIL also believes in giving the bet quality products to their employees. PRAGATI SHARMA
  • 47.
    AARTI INDUSTRIES LIMITED REMUNERATION The remuneration that the AARTI INDUSTRIES LIMITED provides to each of the employees is as follows  Salary: The Board of Directors is to be provided with the Salary of Rs.85, 000/- per month with power to make an annual increment area under discussion to a maximum amount of Rs.1, 50,000/-per month in respect of salary and privilege up to 100% of salary.  Commission: In accumulation to the salary, the whole-time Directors of the AARTI INDUSTRIES LIMITED shall also be entitled to be paid share in comprehensive commission calculated at the rate of 1% of not profit of company computed under section 349 of the companies act, 1956 payable to all company share of such commission shall be payable after the annual accounts are adopted by the shareholders.  Perquisites: Apart from the salary and commission regularly paid, the whole-time Director shall be permitted with the allowances: o House rent allowance of Rs.15000/-per month. o Bonus/ex-gratis: Rs.85000/-per annum. o Compensation of Medical Expenses and/or Medical Insurance premiums for self and family members as per company’s policy. o Personal Accident Insurance as Per Company’s policy. PRAGATI SHARMA
  • 48.
    AARTI INDUSTRIES LIMITED The power of modifying any issue i.e. increase or decrease the amount of the salary or any other and amount of perquisites to be provided by the company subject to a maximum ceiling of 100% of the salary of the whole-time Director will be in the hand of the Board of Directors, Whole-time Director shall also be entitled to following perquisites which shall not include in the computation of the ceiling on remuneration specified here in: o Contribution to Provident fund. Contributions to super annulations fund or annuity fund as per the rules of the company. These will not be included in the computation of the ceiling on perquisites to the extent these either singly or put together are not taxable under the Income Tax, 1961. o Gratuity payable at rate not beyond half a month’s salary for each completed year of service end. o Encashment of leave at the end of the tenure. o Provision of car for business of the company and telephone at residence shall not be treated as perquisites. Use of car for personal purpose and personal long distance calls on telephone shall be billed by the company.  The Salary Payments Salary is usually paid in the first week of every month. Salary officer prepare covers with the name and personal code No., of employees and the pay slip along with cash or cheque as per grade. PRAGATI SHARMA
  • 49.
    AARTI INDUSTRIES LIMITED • Mode of payment in cash or Bank Transfer  Staff- Cash option or Bank Transfer  Officer- Usually Bank Transfer. • The structure of the wages and the salaries The Human Resource Department also deals with wages and salary system. For the AIL the happiness and contentment of the employee’s is the main concern, which is reflected by the health wage and salary structure design in the company. The AARTI INDUSTRIES LIMITED pursues the minimum wage rate policy that is fixed by the Government. The salaries are also determined by the minimum wage rate policy which is set by the government. • The Salary Diminution The time office keeps the documentation of staff employees reporting at duty i.e. the time of entering and the time of leaving. If employees report late on job, in that case the company cuts the salary of that particular employee. The salary diminution rules as per the minutes that are delayed by the employee in reporting themselves to their respective departments are as follows: o If late by 16 min to 35 min = Pay of half hrs o If late by 35 min to 45 min = Pay of 45 min o If late by 46 min to 60 min = Pay of 1 hrs o If late by 2 hrs. to 3 hrs = Pay of half days PRAGATI SHARMA
  • 50.
    AARTI INDUSTRIES LIMITED • Enlightenment :- o For the purpose of this agreement, “Family” means the spouse, the dependent children and dependent parents, if any, of the whole-time Director. o No sitting fee shall be payable to him for attending the meeting of the Board of Directors or committee thereof. o The other terms and condition of the agreement are such as are customarily contained in agreement of similar nature. • The Compensation Packages The compensation package includes: Basic + Dearness Allowance + other financial pays like cash canteen subsidies, washing allowance, shift allowance, contribution of provident fund, gratuity, medical charges, personal pays, inconvenience allowance, chemical, and hazardous allowance, etc. • Shift and Working Hours Timing at AARTI INDUSTRIES LIMITED the shifts are as follows:  General shift 8:00 am to 5:00 pm on all working days.  Lunch time is from 12:00pm to 1:00 pm and 1:00 pm to 2:00 pm.  There are total 3 shifts in the company i.e. morning, evening, and night. PRAGATI SHARMA
  • 51.
    AARTI INDUSTRIES LIMITED (Production of AARTI INDUSTRIES LIMITED goes on non stop i.e. continue round the clock.) • The Industrial Act. The Industrial Acts that is applicable by Human Resource in the AARTI INDUSTRIES LIMITED is as follows. o Factory’s Act, 1948, o Industrial dispute Act, 1947, o Minimum Wages Act, 1948, o Employees provident funds and miscellaneous Act, 1942, o Payment of Bonus Act,1965, o Payment of gratitude Act, 1972, o Payment of wages Act, 1936, o The Worker men’s compensation Act,1923, o Apprentice Act, o The employees State Insurance Act, 1948, o Contract Labor Act, o Payment of Gujarat labor welfare fund. PRAGATI SHARMA
  • 52.
    AARTI INDUSTRIES LIMITED FACILITIES PROVIDED TO THE WORKERS: The workers in the AARTI INDUSTRIES LIMITED are considered as an important part of the company and so the company sees that they provide their workers with the sufficient amenities for the betterment of the workers of their company.  Alter the work method so that there is a reduction in any of the possibilities for straight handling of hazardous materials.  Provide prospect to the workers to talk among them while they are working so that they can develop a healthy working relations among them.  Ensure the availability of a qualified person for the proper treatment the workers and first aid equipment with all necessary ointments and medicines for each kind of infection that may be caused in a chemical industry.  Performing of a regular fitness examination of the workers to notice whether they are in shape and able-bodied without any illness and if any worker found in such condition then provide them with ready contact treatment by a physician or a nurse.  The company also tries to avoid the work of the workers which is in separation or in a remote area of the unit so as to avoid any kind of mishap. PRAGATI SHARMA
  • 53.
    AARTI INDUSTRIES LIMITED SCHEMES The schemes provided by AARTI INDUSTRIES LIMITED to their employees: EDUCATION SCHEME The Scheme decided by the AARTI INDUSTRIES LIMITED for the Scholarship for education to the children of all their employees. This scheme is for those children who have top score in their academic year. The scheme decides scholarship to the children on the basis of their merit. The applicability of the scheme is that the scheme will be applicable to all employees of the company and their children studying in STD. 5th to 12th. This will be free from any biasness from the AARTI’s side. And the deserving child will be getting the benefits of the scholarship scheme. After the submission of the concluding result by the children of their academic year to the specified personnel of AARTI the decisions will be taken. The results will be clustered as per the academic standard & the child who has topped will be sponsored for next year school fees. The approximate budget amount already set and given to the child will be Rs.32000 /-P.A. (Eight students every year x4000/-fees of each.) VOLUNTARY RETIREMENT SCHEME The Human Resource Department has also implemented a special type of policy for the employees named as Voluntary Retirement scheme. Under this scheme, if an employee is above 40 years of age and retire voluntary. He will be entitled to get the minimum 4 month salary excluding the benefit for the remaining years. And not many but only two employees have gone for this scheme. PRAGATI SHARMA
  • 54.
    AARTI INDUSTRIES LIMITED MILK SCHEME At present AARTI INDUSTRIES LIMITED is giving milk coupons to all of its employees except some service department that are excluded from the scheme. Along with the milk coupons, AIL is giving tea allowance to all of its employees @ Rs.4/- per attend. FUNERAL SCHEME The scheme is such that Rs. 2500/- to be given to all the employees on behalf of the society and AARTI INDUSTRIES LIMITED on expiry of any of the dependent family member. Company will compensate the amount to society. This is a small way to show the gratitude and the company’s concern towards the employee and their family. WELFARE SCHEMES FOR EMPLOYEES The AARTI INDUSTRIES LIMITED also provides some welfare schemes for their employees so that they can help their employees in some or the other ways. ∗ Med claim of employees, ∗ Personal accident, ∗ Employees D-link insurances scheme, ∗ Group gratuity scheme, ∗ School admission, ∗ Housing admission, PRAGATI SHARMA
  • 55.
    AARTI INDUSTRIES LIMITED ∗ Cycle loans, ∗ L.I.C through salary. PERFORMANCE APPRAISAL Performance Appraisal is the procedure of evaluating employee’s performance of their employment in terms of their requirement for purpose of administration including placement selection for promotion need for training, providing financial rewards, etc. No firm has a choice as to whether it should or should not appraise their employees. Just as training is required to be endowed after recruitment of the employees, performance appraisal is also to be expected. In AARTI INDUSTRIES LIMITED, Confidential Method is used for performance appraisal of an employee. For the performance appraisal of the employee, the superior or head of the department prepares questionnaires, which is to be filled by their subordinates. In this report the employee describes his strength, weakness, attitude to work, intelligence, attendance work efficiency, etc. With the help of this report, the top level can get the complete idea regarding the employee and his performance in the company. He can take decision regarding promotion, financial rewards, increments, etc. with the help of the information in the report. Whatever is the relation of the superior- subordinate they both have to asses each others performance with complete purity and without any biasness. The assessment of the executive done by their subordinates and that of the PRAGATI SHARMA
  • 56.
    AARTI INDUSTRIES LIMITED subordinates or the non-executive done by their executives will be again assessed by the superiors. OBJECTIVE OF PERFORMANCE APPRAISAL The objective of performance appraisal of the AARTI INDUSTRIES LIMITED is as follows o To determine increments and provide a reliable guide for promotion and transfer to positive of greater responsibility. o To suggest ways of improving the employees performance when he is not found to be up to the mark during the review period. o To maintain individual as well as group development by informing the employee of his performance standard. There are two types of appraisal program in the company. o Form A for the executive and o Form B for the non- executive There is no such procedure of the appraisal but the employees are assessed every at the end of every year. At the end of the year the performance appraisal program is conducted to know the performance of the employees over whole period under review. This review states that which employees who are efficient in their work and needs promotion and that the employees who are incompetent and who needs training to become effective in the work done by them. PRAGATI SHARMA
  • 57.
    AARTI INDUSTRIES LIMITED SELF-APPRAISAL (To be filled by Appraises) ? What are the responsibilities of your job? ? What do you consider the key areas of your present job? ? In your view what are the major contributions/improvement made by you to the organization during the period under review ? What are the areas where you could not achieve your desire goal? What were the reasons? ? What would you consider as your important achievement, Contribution or improvements in the next 3 month, 6 months & one year? ? What will be the action plan do you decided to achieve the target? ? In order to achieve the specified targets that help do you need from the organization? ? Are there any intimate problems (Personal or Organizational) which are likely to come in your way in achieving the enhanced target? ? What co-ordination problems have you faced with your colleagues, other department, etc. in the organization? Your suggestions to improve the same. ? What steps you have taken to improve the performance of your from donates? What do your propose to do in the next 3 to 6 months? PRAGATI SHARMA
  • 58.
    AARTI INDUSTRIES LIMITED ? What training you had in last 12 months? ? Do you have any suggestion for improvement in our organization? ? Are you satisfied with your job, working condition and organization? ? Do you think you need any training, Please specify? PRAGATI SHARMA
  • 59.
    AARTI INDUSTRIES LIMITED LEAVE STRUCTURE The leave structures of AARTI INDUSTRIES LIMITED are as follows.  PAID HOLIDAY : The employees are permitted to take 8 holidays in a year which are considered to be the paid holidays, which are declared by the management in the month of January.  WEEKLY OFF : If an employee is working in a different branch then for them the weekly off is on Sunday. This is for the Vapi branch and other branches also except for an employee who is working at the head office (Mumbai), the weekly off for them is on Saturday and Sunday.  SICK LEAVE : As per previously decided by the AARTI INDUSTRIES LIMITED for the employees 9 days sick leave per annum are on hand and that it is credited on 1st January every year during the first year of employment, however this leave benefit will be available on pro-rate basis accumulated. Sick leave can be at the time of retirement and death of personals only which can be up to a maximum of 72 days.  PRIVILEGE LEAVE : Privilege leave is available @ 30 days per calendar years, which is credited @ 2.5 leave per month for new management staff, @ 2.5 leave per month ID credited after completion of one month. PRAGATI SHARMA
  • 60.
    AARTI INDUSTRIES LIMITED  CASUAL LEAVE: Also the casual leaves are decided by the AARTI INDUSTRIES LIMITED 9 days casual leave per annum is available per and it is credited every year on 1st Jan during the first year of employment, however this leaves benefit will be available on pro-rate basis. Since casual leave benefit cannot be carried to the next year, at the end of the calendar year the outstanding leave balance will automatically be encased and included in the salary of the subsequent month.  SPECIAL LEAVE: The managing director under exceptional circumstances will have the prudence to grant any additional leave, termed as special leave to individuals. Such leave will normally be leave without pay, except it is for the benefit of the company.  OTHER LEAVES: The other leaves are as follows they are the Maternity leave, leave after resignation compensatory leave unauthorized absence etc. PRAGATI SHARMA
  • 61.
    AARTI INDUSTRIES LIMITED MEDICLAIM POLICY The AARTI INDUSTRIES LIMITED is among those fine companies for whom their employees mean a lot to them. The company always notices that all the facilities are properly made available to their employees or not. The AIL not only cares for their employees but also for their family.  The scheme is such that the reimbursement of hospitalization expenses of the family member i.e. spouse children and dependent parents of the employee will be given the medclaim policy according to the policy of the AARTI INDUSTRIES LIMITED.  The eligibility of this scheme is for all those who are voluntarily interested in this scheme and also for the permanent employees of the company who are not covered under ESIC scheme of AARTI INDUSTRIES LIMITED.  The contribution for this scheme is monthly deduction of Rs. 20 per family member and per month from the salary of the employees and the same amount is to be contributed to the company.  The conditions on this policy are as follows: • Employee should notify the name and relation of the employee with the family member for which medical scheme is to be applied. • All types of hospitalization expenses (i.e. medicine, expenses excluding food and convenience) are eligible for reimbursement. • The proof of hospitalization should be cross checked i.e. the hospitalization and medications bills only. • Reimbursement claim should be supported with doctor’s report and hospitalization and medications statement or bills only. PRAGATI SHARMA
  • 62.
    AARTI INDUSTRIES LIMITED • The reimbursement or the Payment of entire amount alleged for the parents mediclaim and any other will be paid after necessary enquiry and confirmation of matter and documents. • The working of the department is that five members committee would be formed among the employee for the scheme with sanction of majority, for one year.  Out of the members of committee two personals are authorized to pay the sum as per official mode. These members are having all the powers of scrutinizing the matters and checking of documents before giving the payment to employees.  All the contribution collected from employees as well as from company on monthly basis is to be deposited in society in a separate bank account maintained for the purpose. All the claims should be settled out of the funds in decided bank account.  Nature of expenses and diseases should be modified as per consideration of facts with the prior effects of six months from the date of amendments done.  All the payments should be paid through cheque after authorization of all the committee members.  Before finalizing the draft of the scheme, the scheme should be approved by the senior HRD personal of the company. PRAGATI SHARMA
  • 63.
    AARTI INDUSTRIES LIMITED SOCIAL RESPONSIBILITY AIL, Vapi seeks to fulfill its responsibility towards society through its CSR activities which mainly cover the areas of health, education, housing, social & cultural needs and disaster relief and can be broadly categorized into: • Labour & staff welfare • Community welfare LABOUR & STAFF WELFARE At AIL, the people believe in fostering an environment that promotes innovation, rewards performance and provides opportunities to people for growth. In addition, the company has a range of initiatives in place for attracting and retaining a high performance work force. The AIL believes in taking care of its people beyond the agreed terms. Some of their employee welfare programs are as follows: Medi-claim insurance policies for all of the employees of AARTI INDUSTRTIES LIMITED have been obtained covering even hospitalization. The expenditure on this account has been round about Rs.7, 00,000 per annum. Recognizing the need for proper housing for all, the Company has disbursed housing loans to the tune of Rs.1 Crore for its junior staff. These loans are partly non-repayable and partly interest-free, with long repayment schedules. This has helped many of the AIL employees to build houses for their families. As of September 30, 2006, outstanding housing loan dues amounted to Rs 76, 15,540. PRAGATI SHARMA
  • 64.
    AARTI INDUSTRIES LIMITED Over the last three years, the AARTI INDUSTRIES LIMITED has contributed around Rs 28, 00,000 to the Aarti Employees Co-operative Fund. AIL provides monetary incentives to their employees to motivate them to opt for birth control and also to cast their vote during local, Vidhan Sabha and Lok Sabha elections. The Company also provides employees with: • Uniforms, safety shoes, rainy shoes, and raincoats; • Tea allowance, food allowance, and milk allowance; • Cycle and vehicle loans; • Marriage gifts, loans for pooja and festivals; • Financial assistance to cover disaster relief, funeral expenses, • and medical expenses including hospitalization for those not • Covered under the ESIS scheme. EMPLOYEE WELFARE EXPENSES Period Labour Welfare taff Welfare Total Amount PERIOD LABOUR STAFF TOTAL WELFARE WELFARE AMOUNT 2004 - 05 Rs 2415729 Rs 917578 Rs 3333307 2005 - 06 Rs 2758586 Rs 547001 Rs 3305587 PRAGATI SHARMA
  • 65.
    AARTI INDUSTRIES LIMITED COMMUNITY WELFARE The AARTI INDUSTRIES LIMITED has adopted a village in Gujarat inhabited by Other Backward Castes (OBCs) and another village in Kutch for rehabilitating earthquake affected people. The aim of AIL is to extend their support to a variety of recipients so that as many as possible can benefit from the company’s financial contributions. COMMUNITY WELFARE EXPENSES Total donations in 2004 05: Rs 6,133,438 Total donations in 2005 06: Rs 13,023,500 From the scores of organizations the AIL have donated funds to, a few are mentioned below: EDUCATION AND RESEARCH RELATED: • Ashadham Seva Mandal • Hirji Bhojraj & Sons K.V.O. Jain Chhatralaya • Adivasi Education and Charitable Trust • Mumbai University Institute of Chemical Technology • Association for Research in Homeopathy • Rural Agro Research & Development Society PRAGATI SHARMA
  • 66.
    AARTI INDUSTRIES LIMITED HEALTHCARE RELATED • Vishwas Hospital Trust • Shushrusha Charitable Trust • Bidada Sarvodaya Trust • Tibetan Medical and Astro Institute • Hira-Mongi Navneet Hospital, Mulund • Parakh Hospital, Ghatkopar SOCIAL WORK AND CULTURAL ACTIVITIES RELATED • Kalgad Sarvodaya Trust • Shri Wagad Sarvodaya Trust • Dhanvallabh Charitable Trust • Shri Vardhman Seva Sangh • Geetai Mission • Rovadan Trust • People's Trust • Child Relief and You (CRY) (working for underprivileged children) • Kutch Mahila Vikas Sanghatan (involved with social empowerment of women) • Shri Mulund K.V.O. Samaj • Gandhi Labour Foundation • Lion's Club of Mulund • Giant's Group of Mandvi - Kutch • Gramin Vikas Samiti (involved with rural development) PRAGATI SHARMA
  • 67.
    AARTI INDUSTRIES LIMITED • Gram Swaraj Samiti (involved with rural development) • Kutch Yuvak Sangh (working for the development of rural youth) • Ankleshwar Industrial Development Society • Vapi Punjabi Charitable Foundation DISASTER RELIEF WORK RELATED • The Prime Minister's National Relief Fund (Tsunami relief) • The Gujarat Chief Minister's Relief Fund • Bhojay Sarvodaya Trust (Earthquake relief in Kashmir) • Kutch Navnirman Abhiyaan (Rehabilitation of earthquake affected people in Kutch) The village in KUTCH adopted by AARTI INDUSTRIES LIMITED PRAGATI SHARMA
  • 68.
    AARTI INDUSTRIES LIMITED SUPPORTING ECONOMIC AND INDUSTRIAL DEVELOPMENT IN VAPI At AIL, Vapi, they believe in actively co-operating with neighboring industries to address common concerns and solve Business-related problems. The Director of AIL, Mr. Kirit Mehta, is the President of the Vapi Industries Association (VIA). He leads the association and takes the necessary initiative for getting basic common facilities for the members. He also handles the task of making representations to various bodies for problems related to roads, water supply, electricity, pollution control, etc. that obstruct the smooth conducting of business. Mr. Mehta is well respected for his contributions towards the development of the chemical industries in Vapi. PRAGATI SHARMA
  • 69.
    AARTI INDUSTRIES LIMITED CORPORATE SOCIAL RESPONSIBILITY POLICY (CSR) At AIL, the Corporate Sustainability Department, consisting of a team of senior management headed by the company’s Managing Director, monitors the company’s CSR & sustainability strategies and their implementation. The department meets regularly to review compliance with the company's CSR policy across the different units and to take informed decisions on related key issues. CORPORATE GOVERNANCE At AIL, integrity, transparency and social responsibility form the core of their corporate behaviour and characterize the way in which they interact with all those who have a stake in the company’s success and with the world at large. For AIL, corporate governance is not a discipline imposed by a Regulator, but something that stems from the culture of an organization. The principles of corporate governance guide the company’s Board of Directors, management and the AIL’s people to create long term sustainable value for their stakeholders. AIL's Board of Directors consists of a team of technocrats, engineers and management graduates having rich experience of more than two decades in the Industry. AIL’s 12-member Board of Directors has both Executive and Non- executive Directors. The board also comprises of an environment consultant, a solicitor, an advocate and a chartered accountant as Independent Directors. PRAGATI SHARMA
  • 70.
    AARTI INDUSTRIES LIMITED The AIL has two Board committees - the Audit Committee and the Shareholders Grievance Committee. The Board has laid down a Code of Conduct (posted on our website (www.aartigroup.com) for all the directors and senior management of the company. AIL's Corporate Governance framework ensures: • Sound corporate practices based on integrity, transparency, accountability, fairness and professionalism - values that are important for sustained growth, increased efficiency and stakeholder confidence. • Timely flow of information to the Board and its committees. • A sound system of internal control and supervision of business operations. • Commitment to good HR policies • Independent verification of the Company's financial, and CSR & sustainability reporting • Timely disclosure of information to all our stakeholders • Compliance with applicable laws, guidelines and regulations The people at AARTI INDUSTRIES LIMITED commit themselves to Corporate Social Responsibility (CSR) by conducting their business activities ethically through a fair and balanced approach, and by being socially responsible and responding to legal, social & ethical issues arising from their commercial activities. PRAGATI SHARMA
  • 71.
    AARTI INDUSTRIES LIMITED The people therefore pledge to work towards continual progress in the following areas: • Respecting their organization's philosophy and striving to be recognized as a good and esteemed corporate citizen. • Complying with legal requirements, wherever they operate. • Developing and supplying useful & safe products and improving the quality of their products and services to be able to contribute to the progress of society. • Conducting business transactions based on fair and free competition. • Striving to make their workplace vibrant to become an employer of choice and focusing on acquiring advanced professional skills & expertise in their field of responsibility. • Protecting the environment, optimizing resource consumption and ensuring the safety of their people. • Supporting human rights, and actively communicating with the company’s stakeholders to understand and respect their interests, thus serving and contributing to their development. • Achieving sustained growth and profitability. PRAGATI SHARMA
  • 72.
    AARTI INDUSTRIES LIMITED At AIL, the people shall strive to promote CSR activities to maintain a balanced approach towards economic goals, safety, quality, the environment and the interests of society, through an effective monitoring of the company’s performance on key issues covered by the CSR programme. AARTI INDUSTRIES believe that these initiatives will help them achieve sustainable development and be recognized as a responsible corporate citizen, consequently enabling our company to emerge as a modern and global company. STRATEGY FOR CSR AARTI INDUSTRY has few strategies for embedding CSR & its sustainability into their business activities. The AIL’s strategies for integrating CSR & sustainability into their management processes and day to day activities are based on our core values and the principles of the UN Global Compact. The company people are aware that by making CSR & sustainability an integral part of their business strategy they will be able to protect the quality of the company’s business activities, their decision-making processes and their capacity to create value for their own company and also their valuable stakeholders. To reach out to AARTI INDUSTRY LIMITED employees, customers and communities and show their concern for the environment, the AIL: • Emphasize that CSR is a shared responsibility for every member of the AIL family. PRAGATI SHARMA
  • 73.
    AARTI INDUSTRIES LIMITED • Reward creativity and leadership skills and provide ample opportunities for personal & professional growth. • Promote team spirit and learning of new skills. • Uphold human rights and the dignity of every employee. • Act promptly on matters related to the health and safety of their people. • Reduce operational costs through energy efficiency, recycling and innovative use of by-products. • Focus on reducing our environmental footprint and greenhouse gas emissions. • Invest in new technologies and produce innovative & sustainable products. • React proactively to customer needs. • Customize solutions to meet customer requirements. • Improve our financial performance to ensure better returns. • Conduct business with transparency and share vital information with stakeholders. • Encourage our employees to actively participate in community development activities. • Respect the rights and needs of the communities we operate in. At AIL; they believe that these strategies will strengthen their platform for growth. PRAGATI SHARMA
  • 74.
  • 75.
    AARTI INDUSTRIES LIMITED FINANCE DEPARTMENT  INTRODUCTION “Financial Management is concern with the efficient use of an important economic resource, namely, Capital funds.”  SCOPE FINANCE DEPARTMENT In AARTI INDUSTRIES LIMITED the Finance Department deals with the problems of rising funds and there effective utilization in the business. Various decisions regarding: • Acquisition of assets. • Specific form of assets where money to be invested. PRAGATI SHARMA
  • 76.
    AARTI INDUSTRIES LIMITED • Composition of its liabilities. Liabilities are covered under the scope of Finance Department. The three functions covered all most all finance functions of an organization. And effect the three major decisions they are:- o Investment Division o Finance Division o Dividend Division  FINANCIAL FUNCTION  Find the cheapest source of finance.  Effective utilization of money.  Capital is raised through issue of shares, debentures; interoperate deposits, financial, institutions, commercial papers, etc.  Negotiations with suppliers.  RESPONSIBILITIES OF FINANCE MANAGER  He keeps all the data related to finance and sees that the funds organization is utilized in the most efficient manner.  He is the most important person in shaping the future of the company and has a vital role in decision of the allocation of capital. PRAGATI SHARMA
  • 77.
    AARTI INDUSTRIES LIMITED  Nowadays finance manager solves important management problem and his role is becoming pervasive and significant.  FUNCTIONS OF FINANCE DEPARTMENT AT AIL  Overhead payment like salary, wages etc.  Cash management.  Calculation of interest payment.  Preparing bank reconciliation statement  Payment like PF, income tax.  Maintaining accounting record. In AARTI INDUSTRIES LIMITED Procure finance from the following Banks and finance Institutions:  BANK OF BARODA  UNION BANK OF INDIA  STATE BANK OF INDIA  ICICI. ETC ∗ Basis Of Acquiring Loans Banks and institutions give loans on basis of net – worth. (Net – Worth = Capital + Net Reserve) ESP = profit / No. Of Shares (Earning Per Shares) Current Ratio Dept – Equity Ratio PRAGATI SHARMA
  • 78.
    AARTI INDUSTRIES LIMITED ∗ Dividend Of Shares  Board Of director decides the percentage of dividend.  Percentage of dividend depends on profit.  Dividend is not an expense but profit distribution. ∗ Short term sources I. Internal  Depreciation funds  Provision for taxation  Accrued expenses II. External  Bank credit  Managing director or directors When a company is going to prepare any new project the company has to consider the following aspects. ¤ cost of project ¤ Means of finance ¤ Financial highlights ¤ Product and capacity  Sources of funds  Use of funds ¤ Projected performance PRAGATI SHARMA
  • 79.
    AARTI INDUSTRIES LIMITED ¤ Existing term loan commitments ¤ Existing W.C. facilities ¤ Proposed financial assets ¤ Introduction of product ¤ Company background ¤ Technical aspects ¤ Industry description ¤ Product description and demand supply position. STRUCTURE:- PRAGATI SHARMA
  • 80.
    AARTI INDUSTRIES LIMITED CHAIRMAN MANAGING DIRECTOR VICE PRESIDNT GENERAL MANAGER DEPUTY ACCOUNT GENERAL OFFICER/ MANAGER CASHER FINANCE ACCOUNT EXECUTIVE ASSISTANT AARTI INDUSTRIES LIMITED had declared an interim dividend of 15%. The directors of AIL now recommend a final dividend of 21% for the year ended 31st PRAGATI SHARMA
  • 81.
    AARTI INDUSTRIES LIMITED march 2002. Total dividend for the year would thus be 36 % and the total dividend payment would be Rs. 418 lakhs subject to declaration of final dividend at Annual General Meeting.  ACCOUNTING DIVISION: The books to be maintained in AARTI INDUSTRIES LIMITED are as follows: ∗ Sales accounting ∗ Purchasing accounting ∗ Bank Transition ∗ Cash Transition ∗ Debit notes ∗ Journal voucher From the above all books, the only description of some books are given below.  RESPONSIBILITY OF FINANCE MANAGER ∗ He keeps all the data related to finance and sees that the funds organization is utilized in the most efficient manner. ∗ He is the most important person in shaping the future of the company and has a vital role in decision of the allocation of capital. ∗ Nowadays finance manager solves important management problem and his role becoming pervasive and significant.  SALES ACCOUNTING PRAGATI SHARMA

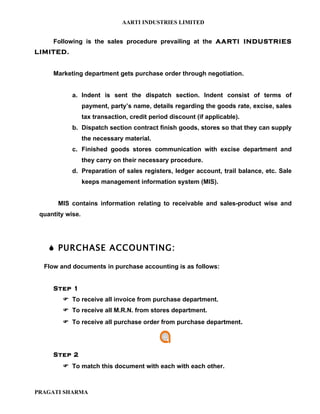

  • 82.
    AARTI INDUSTRIES LIMITED Following is the sales procedure prevailing at the AARTI INDUSTRIES LIMITED. Marketing department gets purchase order through negotiation. a. Indent is sent the dispatch section. Indent consist of terms of payment, party’s name, details regarding the goods rate, excise, sales tax transaction, credit period discount (if applicable). b. Dispatch section contract finish goods, stores so that they can supply the necessary material. c. Finished goods stores communication with excise department and they carry on their necessary procedure. d. Preparation of sales registers, ledger account, trail balance, etc. Sale keeps management information system (MIS). MIS contains information relating to receivable and sales-product wise and quantity wise.  PURCHASE ACCOUNTING: Flow and documents in purchase accounting is as follows: Step 1  To receive all invoice from purchase department.  To receive all M.R.N. from stores department.  To receive all purchase order from purchase department. Step 2  To match this document with each with each other. PRAGATI SHARMA
  • 83.
    AARTI INDUSTRIES LIMITED  To attach copy of P.O and MRN with invoices. Step3  To process the invoice after comparing the same with MRN and PO.  To forward the document to senior manager for management check. Step 4  Executive to hire second check to ensure correctness and accuracy.  To put his/her initials on the rubber stamp at the place market for the purpose.  To forward the document to senior manager for management check. Step 5  Senior manager to check the document from various angles to ensure total control.  To put his/her initials on the rubber stamp at the place marked for the purpose.  To forward the document to account assistant for data entry.  Note:- Dispatch section on receiving the purchase order co-order with production department so that the production can be on line with the demand of the products.  BANK TRANSACTION OPERATION OF BANK ACCOUNT:- AARTI’s major bankers are: ∗ Bank of Baroda, PRAGATI SHARMA
  • 84.
    AARTI INDUSTRIES LIMITED ∗ Punjab national bank, ∗ Dena bank. Performs:  Maintenance of current account  Maintenance of cash credit account over draft facility.  Preparation of BRS (bank reconciliation statement) every month.  CASH BOOK Performs:  Petty cash book which petty cashier operates.  Main cash book which dose main cashier operator.  Note: According to the income tax act if the amount exceeds, rupees twenty thousand then it must be paid by cheque. OTHER INFORMATION:  Corporate dividend tax means tax on dividend payable by the corporate.  Percentage of transfer to general reserve is based on criteria decided by company’s Act.  Deferred liability means liability, which is to be paid at later stage.  Rate of department according to income tax is different than that of company act.  Department not the actual expense but hidden profit. Balance sheet of AARTI INDUSTRIES LIMITED As on 31st march 2005. Liabilities Amounts Assets Amounts SHAREHOLDERS’ FIXED ASSETS PRAGATI SHARMA

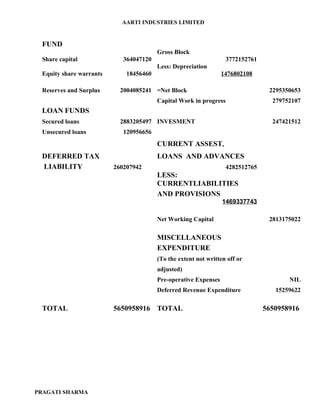

  • 85.
    AARTI INDUSTRIES LIMITED FUND Gross Block Share capital 364047120 3772152761 Less: Depreciation Equity share warrants 18456460 1476802108 Reserves and Surplus 2004085241 =Net Block 2295350653 Capital Work in progress 279752107 LOAN FUNDS Secured loans 2883205497 INVESMENT 247421512 Unsecured loans 120956656 CURRENT ASSEST, DEFERRED TAX LOANS AND ADVANCES LIABILITY 260207942 4282512765 LESS: CURRENTLIABILITIES AND PROVISIONS 1469337743 Net Working Capital 2813175022 MISCELLANEOUS EXPENDITURE (To the extent not written off or adjusted) Pre-operative Expenses NIL Deferred Revenue Expenditure 15259622 TOTAL 5650958916 TOTAL 5650958916 PRAGATI SHARMA
  • 86.
    AARTI INDUSTRIES LIMITED Profit & Loss Account for the year ended 31 st March, 2006 INCOME Income from operation 7,861,750,467 other income 47,810,802 Increase in inventory 220,512,506 TOTAL 8,130,073,775 EXPENDITURE Manufacturing Expenses 5,765,521,854 Purchase of Goods Traded In 601,311,395 Office and administration Expenses 86,832,124 Selling and Distribution Expenses 518,133,693 Interest and financial Charges 204,004,164 Non-Operating Expenses and losses 16,244,538 TOTAL 7,192,047,768 Profit Before Depreciation 938,026,007 Less: Depreciation 221,869,002 Profit Before Tax 716,157,005 Less:Provision for taxation(including fringe benefit tax) 162,300,000 Profit After Tax 553,857,005 Less: Provision for Deffered Tax 63,213,480 Profit After deffered Tax 490,643,525 Add: Balance of Profit and Loss Account Brought Forward 1,537,363,110 Add: Provision for Diminution in the value of Investments- Quoted NIL Less: Prior Years' adjustment for others 18,520,032 2,009,486,603 less:Transfer to General Resereve 50,000,000 1,959,486,603 Less:Dividend 61,888,011 Less:Dividend 50,966,597 Less:Proposed Dividend 29,123,770 Less:Tax On Dividend 19,912,468 Balance Carried Forward To Balance Sheet 1,797,595,757 PRAGATI SHARMA
  • 87.
    AARTI INDUSTRIES LIMITED Earning Per Share 6.74 RATIO ANALYSIS A Ratio is simply one number expressed in terms of another, it is an expression of relationship spelt out by dividing one figure by another. The ratio analyses of the AARTI INDUSTRIES LIMITED are as follows: ¥ CURRENT RATIO:- Current Ratio = Current Assets / Current Liabilities 2005 = 3,357,688,435 / 1,162,972,259 = 2.887 2006 = 4,282,512,765 / 1,469,337,743 = 2.914 INTERPRETATION : A current ratio establishes the relationship between total current assets and current liabilities. A current ratio of 2:1 is considered ideal as a rule of thumb. The ratio of AIL is 2.914: 1, indicating a very comfortable liquid position. PRAGATI SHARMA
  • 88.
    AARTI INDUSTRIES LIMITED ¥ Liquid Ratio:- Liquid Ratio = Liquid Assets / Liquid Liabilities Liquid Assets = current Assets – stock Liquid Liabilities = current Liabilities – Bank overdraft 2005 = 3,357,688,435 – 950,823,968 / 1,162,972,259 = 2,406,864,467 / 1,162,972,259 = 2.069 2006 = 4,282,512,765 – 1,216,471,792 / 1,469,337,743 = 3,066,040,973 / 1,469,337,743 = 2.086 INTERPRETATION : This ratio is establishes a relation between absolute liquid assets to liquid liabilities. The ideal ratio is 2:1 and liquid ratio is 2.086:1. It is means the liquidity position of the company is satisfactory. ¥ Net profit Ratio:- Net profit Ratio = Net profit *100 / Sales 2005= 472,267,814 *100 / 6,854,771,081 = 6.889 2006=553,857,005 *100 / 7,861,750,467 = 7.04 INTERPRETATION : It expresses the relationship between net profit and sales. This ratio shows a better profitability of the firm as compared to the whole industry. This suggests a satisfactory position. PRAGATI SHARMA
  • 89.
    AARTI INDUSTRIES LIMITED ¥ Return on capital employed:- Return on capital employed = Net profit *100 / Share capital + Reserves & Surplus + Long term loan 2005 = 472,267,814 *100 / 2,249,124,783 = 20.997 2006 = 553,857,005 *100 / 3,004,162,153 = 18.436 INTERPRETATION : The standard return on capital employed is about 15%. Return on capital employed ratio is 18.436%. These indicate the higher productivity of the capital employed. ¥ Debt Equity Ratio:- Debt Equity Ratio = Long term debt / Shareholder’s fund 2005 = 2,249,124,783 / 2,057,899,714 = 1.092 2006 = 3,004,162,153 / 2,386,588,821 = 1.258 INTERPRETATION : It expresses the relationship between debt and equity. The standard debt- equity ratio is 2:1. It means for every 2 share there is 1 debt. The debt-equity ratio is 125.8%, this indicates that the states of long-term creditor are move and indicates week financial structure. PRAGATI SHARMA
  • 90.
    AARTI INDUSTRIES LIMITED ¥ Capital Turnover ratio:- Capital Turnover ratio = Net sales / Total Capital Employed 2005 = 6,854,771,081 / 4,504,018,959 = 1.521 2006 = 7,861,750,467 / 5,650,958,916 = 1.391 ¥ Return on Share holder’s fund:- Return on Share holder’s fund = Earning after tax *100 / Share holder’s fund 2005 = 472,267,814 *100 / 2,057,899,714 =22.95% 2006 = 553,857,005 *100 / 2,386,588,821 =23.20% ¥ Fixed Assets Turnover ratio:- Fixed Assets Turnover ratio = Net sales / Net Block 2005 = 6,854,771,081 / 1,861,448,777 = 3.682 2006 = 7,861,750,467 / 2,295,350,653 = 3.425 INTERPRETATION : The ratio establishes a relationship between the fixed assets and sales. The standard fixed turnover ratio is 5 times. A high ratio indicates better utilization of fixed assets. A low ratio indicated under utilization of fixed assets. So the company’s ratio indicates under-utilization of fixed assets. PRAGATI SHARMA
  • 91.
    AARTI INDUSTRIES LIMITED ¥ Net Working Capital Turnover Ratio:- Net Working Capital Turnover Ratio = Net sales / Net Working Capital 2005 = 6,854,771,081 / 2,194,716,176 = 3.123 2006 = 7,861,750,467 / 2,813,175,022 = 2.794 INTERPRETATION : The term working capital refers to excess of current assets over current liabilities. This ratio establishes a relationship between working capital and sales. This ratio enables to know efficient utilization of working capital of an organization. PRAGATI SHARMA
  • 92.
    AARTI INDUSTRIES LIMITED Shareholding Pattern of AARTI INDUSTRIES LTD as On 31st March 2006  AUTHORIZED CAPITAL:- 9, 00, 00,000 Equity Shares of Rs. 5/- Each  ISSUED, SUBSCRIBED & PAID-UP:- 7, 28, 09,424 Equity Shares of Rs. 5/- Each fully paid up  MARKET PRICE DATA:- Month Bombay Stock Exchange National Stock Exchange High(Rs.) Low(Rs.) Volume High(Rs.) Low(Rs.) Volume Jan 2006 165.80 76.50 513468 165.90 78.55 1029720 Feb 2006 82.20 72.05 538856 82.25 73.50 579879 Mar 2006 85.00 73.00 1422548 86.00 74.00 1098204 PRAGATI SHARMA
  • 93.
    AARTI INDUSTRIES LIMITED  SHAREHOLDING PATTERN AS ON 31ST MARCH 2006 Category No. of Shares % Promoters – Indian 32724612 44.95 Bodies Corporate 1788669 2.45 NRIs/OCBs 389064 0.53 Banks, Financial Institution 7500 0.01 Mutual Funds 8223662 11.29 FII 3665654 5.03 Public 26010263 35.74 Total 72809424 100.00  DISTRIBUTION OF SHAREHOLDING AS ON 31ST MARCH 2006 PRAGATI SHARMA
  • 94.
    AARTI INDUSTRIES LIMITED No. of Shareholders Share Held Shares Number % Number % Less then 500 8713 54.06 1619101 2.22 501-1000 3519 21.83 2355917 3.24 1001-2000 2726 16.91 3539829 4.86 2001-3000 321 1.99 845174 1.16 3001-4000 152 0.94 554790 0.76 4001-5000 84 0.52 381802 0.52 5001-10000 232 1.44 1655480 2.27 Above 10000 370 2.30 61857331 84.96 Total 16117 100.00 72809424 100.00 PRAGATI SHARMA
  • 95.
    AARTI INDUSTRIES LIMITED CHARTS € TOTAL INCOME Total Income ) 790.96 es or 800 688.06 Cr 700 511.59 600 in 474.32 Series1 es 500 345.85 pe 400 u 300 200 (R 100 0 2001-02 2002-03 2003-04 2004-05 2005-06 Years € EARNING PER SHARE Earning Per share 35 30.02 30 24.39 23.06 25 20 (Amount in Rupees) 12.78* 15 10 6.74# 5 0 2001-02 2002-03 2003-04 2004-05 2005-06 Years PRAGATI SHARMA
  • 96.
    AARTI INDUSTRIES LIMITED € PROFIT BEFORE & AFTER TAX Profit Before & After Tax 80 71.62 70 58.23 55.39 60 50.06 47.23 50 41.05 39.56 (Rupees in Crores) 32.87 40 31.55 29.12 30 20 10 0 2001-02 2002-03 2003-04 2004-05 2005-06 Years € DIVIDEND PAYOUT Dividend Payout 30 25.95 25.00 25.64 25 23.00 20 Payout (%) 14.2 15 12.26 8.33 9.10 10 7.89 5 2.43 0 2001-02 2002-03 2003-04 2004-05 2005-06 Years PRAGATI SHARMA
  • 97.
    AARTI INDUSTRIES LIMITED € NET WORTH Net worth 235.29 250 203.95 200 172.29 144.56 150 (Rupees in Crores) 123.75 100 50 0 2001-02 2002-03 2003-04 2004-05 2005-06 Years € BOOK VALUE Book Value 160 141.97 140 119.13 120 101.98 100 (Amount in Rupees) 80 56.03* 60 32.32# 40 20 0 2001-02 2002-03 2003-04 2004-05 2005-06 Years PRAGATI SHARMA
  • 98.
  • 99.

    AARTI INDUSTRIES LIMITED MARKETING DEPARTMENT  INTRODUCTION OF MARKETING The dictionary definition of Marketing is selling, advertising, promotion, etc. Marketing affects our day to day life in whatever we do right from buying vegetables clothes or grocery items. The most eye-catching and best quality is that towards which everyone is attracted. And to make the product eye-catching and sell your product in the market what you need to do is marketing of your product. Marketing is nothing but a consequence of a cautious planning which is to be done by the people of the company for making their product a success and that to sell or market their product in the market. Things done with awareness and complete homework with all the right calculations and complete knowledge the new developments and happenings in the market would result in the excellent marketing. Nowadays the organizations have started concentrating on the different ways in which they can cater a maximum number of the customers and also how they can promote their products. PRAGATI SHARMA
  • 100.
    AARTI INDUSTRIES LIMITED The same is in the case AARTI INDUSTRIES LIMITED. The AIL tries its best to satisfy their customers by providing with the best quality products. AIL considers quality of its products as the company’s biggest strength. The AIL by giving the proper amount of pricing of its products is able to cater a good amount of customers for the company. The consumers are at the present time are becoming more and more aware of the products availability. The customers are becoming choosy and not only concentrate on the products quality but also on how the companies present their products in front of them. The customers very carefully observe the features, design, pricing, and others. By observing each of the details of the product the customers tries to make perception of the product and then try the product. In todays competitive world satisfaction of the customer is the most important job of the companies. So in today’s time the marketing is done according to the needs wants and the demands of the customers so that whatever the customers needs that is produced to make the customers satisfied. AARTI chemical is basically manufacturer of chemical products and the company has a number of chemicals that are manufactured in the company. Being a chemical company, consumers may not be directly using AIL's products, and it may be difficult to see how the chemicals the AIL produce enrich the lives of people. But the AARTI INDUSTRIES do contribute towards improving their quality of life since the end users of their products are industries ranging from agrochemicals and dyes to speciality chemicals and pharmaceuticals - markets that are critical to long-term sustainability. By supplying high quality and good value products to their customers, the AARTI INDUSTRIES LIMITED indirectly help PRAGATI SHARMA
  • 101.
    AARTI INDUSTRIES LIMITED people to have access to better medicines, fertilizers and diverse items of daily use. In other words, greening the supply chain management plays a significant role in AIL’s business strategy. AIL`s prime activity is to manufacture organic chemicals, mainly benzene- based intermediates. They also manufacture sulphuric acid and allied products, which provide basic building blocks to most sectors of the chemical industry. As the companies seeks for the company who provide quality products and that the quality products are been produced by the AIL. AARTI INDUSTRIES being a chemical manufacturing company manufactures benzene based products and that the distribution of the products of the company is as follows: o 50% exported o 30% for sister concern o 20% other companies PRAGATI SHARMA
  • 102.
    AARTI INDUSTRIES LIMITED  50% of the manufacturing of AIL’s products is exported to the foreign countries.  30% of the AIL’s products is used by the sister concern of the AIL.  20% of the manufacturing of the AIL is being sent to the Indian market. THE COMPETITORS OF AARTI INDUSTRIES LIMITED. The competitors of AARTI INDUSTRIES LIMITED are as follows:  Alankar Industries  Anami Organics  Apurva chemical  Chirag Organics Pvt Ltd  Kamala Intermediates  Nascent Chemical Ind. Ltd  Micro Fine  Shanti Intermediates Pvt Ltd.  Vapi Acid & chemicals  Vapi Organic Chemical Pvt Ltd THE CUSTOMERS OF AIL The customers of the AIL are many in India as well as in the abroad. NAME OF THE COMPANY PRODUCT PRAGATI SHARMA
  • 103.
    AARTI INDUSTRIES LIMITED Dr Reddy DMS Bharat chemicals PNCP Sister concern Drugs & Organics While trading abroad the AARTI INDUSTRIES LIMITED markets its product to the European countries the most. During the year under review, the company has achieved Sales turnover of Rs. 786.18 crores. While in the previous year the sales turnover was Rs. 685.47 crores, registering a growth of 14.69%. THE SUPPLIERS OF AIL There are many companies in the suppliers list of the AIL but some of them companies that supply chemical raw materials to AIL are as follows: NAME OF THE COMPANY PRODUCT Standard Alkaline GSC Chlorine Reliance Jamnagar & Hajare Benzene Deepak nitrite nitric Acid Udaipur rock phospect • Reliance Industries Ltd. • Bharat Petroleum Corporation Ltd. • National Organic Chemical Industries Ltd. • Standard Albalies Ltd. PRAGATI SHARMA
  • 104.
    AARTI INDUSTRIES LIMITED • National Rayon Corporation Ltd. • Grasim Industries. • Gujarat Narmada Valley Industries Corporation. • Deepak Nitrate ltd. • Transport ltd Dubai. • Helm Chemicals Germany • Universal Chemical Bahrain. THE STRUCTURE OF AARTI INDUSTRIES LIMITED (AIL) OF MARKETING DEPARTMENT THE MANAGING DIRECTOR BOARD OF DIRECTORS MARKETING MANAGER SALES MENS THE MARKETING OBJECTIVE OF AIL The marketing objective of the AIL are PRAGATI SHARMA
  • 105.
    AARTI INDUSTRIES LIMITED • To make awareness of their product. • To become the leader of chemical manufacturing products. • To earn profit. • To have maximum sales of their product with maximum customers. • Enhancing economic growth • Strengthening social responsibility • Intensifying environmental commitment • Ensuring a better tomorrow THE HOLISTIC MARKETING APPROACH OF AIL The traditional way of thinking of the people was marketing is to sell their product in the market. But with the passage of time the companies have started thinking in a broad manner now the most important thing for them is to retain their customer and make a different and a good position of their company in the market. For that the companies have started adopting the holistic marketing concept. The holistic marketing concept takes in view not only the customers but also the relationship of the company with their customers, stakeholders, their management and the department and each of their other links prevailing in the market. With all of these maintaining a position in the society is also one of the important matters. The AARTI INDUSTRIES LIMITED has maintained a very good relation with their employees, customers, stakeholders, as well as the society which can be seen in the welfare done by the AIL. THE HOLISTIC MARKETING MODEL INTERNAL INTEGRATED PRAGATI SHARMA
  • 106.
    AARTI INDUSTRIES LIMITED HOLISTIC MARKETING SOCIALLY RELATIONSHIP RESPONSIBLE We can say that AARTI INDUSTRIES LIMITED also follow the holistic marketing concept is by the following reasons. INTERNAL: The AIL takes care of their employees in a proper way. Right from their senior management to their employees and staff. Everyone is treated as if a family. The AIL takes care of the needs and the wants of the employees and that the employees in return work efficiently and effectively. Also the strategies, principles, recruitment, selection, and motivation to the employees are done very carefully of each and every department. INTEGRATED: The integrated marketing is the marketing where the task of the marketing of the products is done. The marketing mix is an essential part of marketing and the 4 P’s is well considered here (Marketing Mix explained in the later part). So the AIL tries its best to develop its marketing mix. PRAGATI SHARMA
  • 107.
    AARTI INDUSTRIES LIMITED SOCIALLY RESPONSIBLE: In today’s world being socially responsible is very important. The AIL has tried its best to be a socially responsible company by maintaining the ethics and moving on with the environment al, legal and the community trends of the place it is situated. RELATIONSHIP MARKETING: The relationship marketing is maintaining the relationship with the customers stakeholders, suppliers distributors etc, and being loyal to each of them. The AIL is among those companies who does the relationship marketing as the AIL not only maintains the relationship with each of them but also treat them as their family whether the customers suppliers distributors are oft the local market or of the foreign market. PRAGATI SHARMA
  • 108.
    AARTI INDUSTRIES LIMITED THE ENVIRONMENT THAT AFFECT THE COMPANY The company is to be found facing many different environment that affect the company adversely these environments are the classified under the two environments they are: • The internal environment and • The external environment. The internal environments that affect the company are as under  The customers The public and the customers are the key factor which may prove fruitful as well as harmful. The customers if properly satisfied would demand more products and make the company reach at the top but if they are not satisfied then the company may even shut down. In AIL the customers are seen as the key part so if they are not satisfied then the company will have to face problems.  The suppliers PRAGATI SHARMA
  • 109.
    AARTI INDUSTRIES LIMITED The suppliers are also an important part as the suppliers are the people who provide us with the basic raw materials so if they are not with the company then the company will face problems. If these people are not satisfied on time then the company would face many problems.  The competitors Competitors are that part of the company which would affect the company adversely. As the competitors increase or decrease the price range or any sort of new innovation that the competitors company does will have a direct effect on the company itself. (AARTI INDUSTRIES LIMITED) The external environments that affect the company are as under  The technological environment The technology plays a vital role for a company as if the technology adopted by the company is old and that the competitor has the technology which is new and involves less amount of money and so the competitors if they gain the advantage before the company itself then the competitors will gain a competitive advantage and the will not be able to achieve the position which the company desires.  The political / legal environment The political environment is pertaining to the government. If he government makes any policy which is not in the favor of the company like increasing the tax rate, increase the export-import duties, or put PRAGATI SHARMA
  • 110.
    AARTI INDUSTRIES LIMITED more duties on the goods so the company will have to spend more and this will affect the company adversely. CORE COMPETENCIES The core competencies of AIL are as follows:  Quality and Logistics,  Continuous Cost Control,  High Value Addition,  Diversified Product Range,  Loyal Work Force,  In - House R&D,  Customer Satisfaction. AARTI INDUSTRIES LIMITED’S CORPORATE VISION • To retain leadership in the domestic market. • To attain a significant presence in global markets. • To become suppliers of choice to leading customers. • To be always committed to employees, customers, shareholders, and society at large. AARTI INDUSTRIES SUSTAINABLE GROWTH MISSION PRAGATI SHARMA
  • 111.
    AARTI INDUSTRIES LIMITED • To become one of the most respected organizations in the chemical industry and a name people trust through quality products and sound corporate values. • To grow into a large corporate entity by increasing the company’s reach to newer global markets, and expanding the company’s product line up through new product developments. • To use cost-effective and innovative manufacturing methods supported by proven, eco-friendly and safe technologies. • To become a customer-driven company by providing customized solutions and services to meet changing customer requirements. • To encourage and nurture a winning organizational culture by focusing on providing their people opportunities for personal and professional growth. • To maintain a balance between the company’s corporate goals and social responsibilities. • To create long-term, sustainable growth for all the company’s stake- holders. THE MARKETING MIX OF AARTI INDUSTRIES LIMITED The marketing mix is made up of four elements namely the • Product, • Price, • Place, and PRAGATI SHARMA
  • 112.
    AARTI INDUSTRIES LIMITED • Promotion. Let us see the marketing mix of AARTI INDUSTRIES LIMITED one by one. PRODUCT:- Product is anything that is offered to a market to satisfy a want or their needs. The product having nearly all quality, performance, or innovative features are generally easily accepted by the customers. So a product should possess all of these qualities so as to retain their customers for an extended time. The products of the AARTI INDUSTRIES are in the maturity stage of the product life cycle. As in the maturity stage sales of the product is not too high and not low so the same is in the case of the AARTI INDUSTRIES product the products sales are not too high and not too low. The product portfolio of AARTI CHEMICALS LIMITED portfolio consists of: 1) BENZENE-BASED INTERMEDIATES 2) SULPHURIC ACID & ITS ALLIED PRODUCTS. 3) AGROCHEMICALS & FERTILIZERS 4) ACTIVE PHARMACEUTICAL INGREDIENTS (APIs) 5) OTHER INTERMEDIATES & SPECIALITY CHEMICALS PRAGATI SHARMA
  • 113.
    AARTI INDUSTRIES LIMITED THE PRODUCT LINE AND PRODUCT DEPTH Para Nitro Chloro Benzene (PNCB) PRAGATI SHARMA
  • 114.
    AARTI INDUSTRIES LIMITED • • • • • • • • • • • • • • PRAGATI SHARMA
  • 115.
    AARTI INDUSTRIES LIMITED Ortho Nitro Chloro Benzne (ONCB) PRAGATI SHARMA
  • 116.
    AARTI INDUSTRIES LIMITED • • • • • • • • • • • • • • PRAGATI SHARMA
  • 117.
    AARTI INDUSTRIES LIMITED Dinitro Chloro Benzene (DNCB) • • • • • Para Dichloro Benzene (PDCB) PRAGATI SHARMA
  • 118.
    AARTI INDUSTRIES LIMITED • • • • • • • • • • • PRAGATI SHARMA
  • 119.
    AARTI INDUSTRIES LIMITED Ortho Dichloro Benzene (ODCB) • • • • • • • • • PRAGATI SHARMA
  • 120.
    AARTI INDUSTRIES LIMITED Nitro Benzene PRAGATI SHARMA
  • 121.
    AARTI INDUSTRIES LIMITED • • • • • • • • • • • • PRAGATI SHARMA
  • 122.
    AARTI INDUSTRIES LIMITED Alkylated Anilines & Toluidines PRAGATI SHARMA
  • 123.
    AARTI INDUSTRIES LIMITED • • • • • • • • • • • • • • PRAGATI SHARMA
  • 124.
    AARTI INDUSTRIES LIMITED Chloro Phenols PRAGATI SHARMA
  • 125.
    AARTI INDUSTRIES LIMITED • • • • • • • • • Fluoro Compounds PRAGATI SHARMA
  • 126.
    AARTI INDUSTRIES LIMITED • • • • • • • • • • • • • • PRAGATI SHARMA
  • 127.
    AARTI INDUSTRIES LIMITED Agrochemicals • • • Other Major Products Bulk Drug Intermediates / Speciality Chemicals PRAGATI SHARMA
  • 128.
    AARTI INDUSTRIES LIMITED • 4 - Nitro Aniline (Para Nitro Aniline)-100-01-6 • Ortho Chloro Aniline (95-51-2) • 2- Chloro Nitro Benzene (Ortho Nitro Chloro Benzene) (88-73-3) • Ortho Anisidine (90-04-0) • Ortho Phenylene Diamine (95-54-5) • Di Methyl Sulphate (DMS) • 2,5 Dichloro Nitro Benzene (2,5 DCNB) (89-61-2) • 4- Chloro 2- Nitro Aniline (Para Chloro Ortho Nitro Aniline) (89-63-4) • Para Chloro Ortho Anisidine (93-50-5) • 1,2 Dichloro Benzene (Ortho Dichloro Benzene) (95-50-1) • 1,3 - Dinitro Benzene (Meta Di Nitro Benzene) • Meta Phenylene Di Amine • N,N Di Ethyl Meta Toluidine (DEMT) • 4-Chloro Phenol (PCP) • 2,3 Di Chloro Phenol • 3:4 Di Chloro Phenol • Mono Chloro Benzene (MCB) • Meta Di Chloro Benzene • Mono Chloro Benzene Para Sulphonic Acid PRAGATI SHARMA
  • 129.
    AARTI INDUSTRIES LIMITED Bulk Pharmaceuticals DYES DYES AVAILABLE IN LIQUID FORM ACID BLUE 15 ACID VIOLET 17 ACID VIOLET 49 ACID BLACK 194 BASIC YELLOW 2 BASIC VIOLET 1 BASIC VIOLET 3 BASIC GREEN 4 BASIC GREEN 1 Bulk Drugs under R & D Anti-Hypertensives Anti-Cancer Perindopril Imatinib Mesylate Trandolapril Capcetabine Cilazepril Irenotican Bronchodilators Anti-Diabetic Loteprednol Glimepiride Mometasone Ciclesonide Flumethasone Anti-Deprresents Desonide Ziprasidone Aripiprazole Zaleplon Paroxetine HCL PRAGATI SHARMA
  • 130.
    AARTI INDUSTRIES LIMITED Dyes PRAGATI SHARMA
  • 131.
    AARTI INDUSTRIES LIMITED DYE CLASS HUES ACID BASIC DIRECT REACTIVE SOLVENT YELLOW 17, 23, 36 42, 96, 99, 100 194, 204, 241 2 11, 12, 44 50, 111 7, 17, 18, 22 42, 81, 84, 145A, 160A 2, 14, 16, 33 82 ORANGE 3, 7, 10, 56, 75 116, 142 162 1, 2 34, 39 4, 12, 13, 14, 84 2, 62 BROWN 75, 160 165, 355 365 1 9 RED 18, 52, 73, 81, 88, 97, 119, 131, 151, 186 195, 283 357, 362 23, 80, 81 11, 35, 49, 141 152, 180A 195A, 196 1, 23, 24, 49 VIOLET 7, 17, 49 85, 90, 92 1, 2, 3, 4, 10, 14 9, 51 1, 12 PRAGATI SHARMA
  • 132.
    AARTI INDUSTRIES LIMITED QUALITY Quality is one of the important and basic aspects of marketing. Being a chemical company, consumers may not be directly using AIL's products, and it may be difficult to see how the chemicals they produce enrich the lives of people. But the AIL do contribute towards improving the people’s quality of life since the end users of their products are industries ranging from agrochemicals and dyes to speciality chemicals and pharmaceuticals - markets that are critical to long-term sustainability. By supplying high quality and good value products to their customers, AIL indirectly help people to have access to better medicines, fertilizers and diverse items of daily use. In other words, greening the supply chain management plays a significant role in their business strategy. DESIGN AND FEATURES As the product is chemical the design and the features is not possible. The products (chemicals) in the AIL are either in the powdered form or in the liquid form. SIZES For the solid form, the plastic gunny bags have the minimum size of about 50 kg and the maximum above 450 and this is mostly used for the local market packaging and the demand of the customers. For the export purpose he plastic gunny bags are only used but the size of the gunny bag differs. The size turns to be 500 kg when it is sent to the foreign customers. For the liquid form the containers are used. These containers are packed in such a way that the chemical does not react with the drums. These drums are of different sizes PRAGATI SHARMA
  • 133.
    AARTI INDUSTRIES LIMITED BRAND NAME The product i.e. the chemical is marketed in the market in the brand name of AARTI INDUSTRIES LIMITED (AIL) in INDIA as well as in the foreign markets SERVICES The services offered by the AARTI INDUSTRIES to its customers after their customers receive the order are as follows: o Product information, o Safety data sheets, o Instructions for the of the product if facing any problem, o Product handling guidance. PRAGATI SHARMA
  • 134.
    AARTI INDUSTRIES LIMITED PRICE:- In what ever we do we do pay price for it. When we purchase certain things, we make certain things and also that ethically when we are wrong and do anything bad we pay price for that. Previously the pricing used to be set with the negotiations of the buyers and the sellers. The price for which both of them agree used to be the price of the product. Though at that time also bargaining prevailed but coming up to a price with both parties agreement was there. In the traditional times the people used to believe that the things that are of high prices are of very good quality where as in today’s time the quality is seen first and then the pricing. The customers needs are as kept in mind while making the product in the same way the pricing of the product are also kept by keeping in mind the customers and so different segments are been targeted for the different price and according to them the pricing are kept by the companies. The pricing along with the product also plays a significant role in attracting the customers and some times gaining competitive advantage also. A price if properly set with a quality product then it would tend the customers to purchase the product. As many times the customers are ready to pay a good amount of price for the product but with the expectation of providing quality products to them. The buyers force the sellers to reduce the prices of their product and that is the reason for which the discounting system has been emerged so that the buyers get due benefits of the price reduction and the manufacturers are also in advantage. PRAGATI SHARMA
  • 135.
    AARTI INDUSTRIES LIMITED METHOD OF SETTING PRICE BY AARTI INDUSTRIES LIMITED:- The pricing in the AARTI INDUSTRIES LIMITED are set by the board of directors with the marketing managers. The companies also set their pricing in many of the ways. As in small companies the pricing is set by the boss. Whereas in the big industries the pricing policies, pricing objectives are set by the product or the department managers and later on it is approved by the top level management of the industries. Even in AARTI INDUSTRIES LIMITED the prices are firstly been set by the managers an then it is given to the top level management with the complete report with reasons of the set prices and after analyzing the whole report the top level management approves it (if the prices that are set are proper then the price is finalized and if not it is again reviewed and then by discussions the prices are set) And also in some industries where there are different department s like the finance department, marketing department, human resource department, production department, research and development, stores department health and safety department etc. the pricing is the key important area there is a separate pricing division which determines the appropriate price. And this pricing department reports to the marketing department, finance department and also the op level management. Previously companies used to think that pricing means profitability but now days with profitability it is getting more customers. PRAGATI SHARMA
  • 136.
    AARTI INDUSTRIES LIMITED The following method is followed in setting the pricing of the products. MATERIAL COST EXPENSES (Electricity + water + Wages + salary) OVERHEAD EXPENSES PERCENT OF PROFIT THE PRICE (SELLING PRICE) The prices the chemicals of AARTI INDUSTRIES LIMITED are set in the following way: o Firstly the material cost is taken into consideration and counted. He 60% of the set price is the cost of the raw material involved in the making of the product. PRAGATI SHARMA
  • 137.
    AARTI INDUSTRIES LIMITED o Then the expenses are being calculated that is used or spent in the making of the product. These expenses are the electricity (power), water expense (pani) and the salary & wages (pagar) that are considered. These expenses involve 20% weightage. o After the expenses the overhead expenses are been considered. These overhead expenses may be the individual overhead cost. This expense has 20 %of weightage. o Lastly the percentage of profit is been kept by the company. o Then finally the selling price of the products is been decided or finalized by the AIL. While AARTI INDUSTRIES LIMITED sets its price of a product at that time the company keeps in mind the following things: o Prices of that particular product for which the prices are to be set by the company, with the prices that are kept by the competitors of AIL o The quality of the product that are to be given to their customers. If the quality is very high than the prices are charged according to it by the AIL. PAYMENT PERIOD The payment period is as such not fixed by the AARTI INDUSTRIES LIMITED. Sometimes the company takes advance money from the parties (consumers). It depends upon the consumer/ customer if the customer is old and important then the maximum period for the payment given to them will be 15 days. There is as such no policy fixed or decided for the company for the payment. PRAGATI SHARMA
  • 138.
    AARTI INDUSTRIES LIMITED PLACE:- DOMESTIC MARKET OF AIL AARTI INDUSTRIES LIMITED can be said as one of he largest producer of benzene based chemical product and intermediary chemicals in India and the products manufactured by the AARTI INDUSTRIES LIMITED are use in financial transactions without working with an agent or a broker. By using the internet, the most used media nowadays. The purchasing agents can search for the best vendors and also the values. Nowadays companies are trying to identify the customers who are more profitable to the company and most importantly who possesses values that are matching the company’s values in addition. This will help in developing quite a excellent amount of rapo between the company and its customers / consumers to carry out a long lasting relationship. As value helps in building relationships so does the service helps as it is the key point to be considered by the company as by providing the proper amount of service the company can win the heart of their customers. The companies are basing their decision on customer’s lifetime value rather than on intermediate profit maximization. Each company’s set up of belief and practice are under going challenges and change. These days all the business organization tries to do this type of marketing activities and they give main concern to marketing department because without the marketing tricks the organization will not exist. PRAGATI SHARMA
  • 139.
    AARTI INDUSTRIES LIMITED The chemicals that are mostly sent in Indian markets are the 1) benzene-based intermediates 2) Sulphuric acid & its allied products. 3) Agrochemicals & fertilizers 4) Active pharmaceutical ingredients (apis) 5) Other intermediates & speciality chemicals. The states in which the AARTI INDUSTRIES LIMITED markets its goods are as follows:  Gujarat,  Maharashtra,  Hariyana  Himachal Pradesh,  Punjab. And others PRAGATI SHARMA
  • 140.
    AARTI INDUSTRIES LIMITED EXPORTS OF THE AARTI INDUSTRIES LIMITED When the AARTI INDUSTRIES LIMITED realized the fact that the industry can cope up with their competitors and can also export their products in the foreign countries they begin exporting their products to the different countries. At that very time the AARTI INDUSTRIES LIMITED registered itself in the exports of Rs. 684 million which is equivalent to US $16.10 million. Over a year the company has registered a compounded average annual growth rate of more than 65 per cent. Each year the AARTI INDUSTRIES LIMITED has seen a favorable rise in the volume of the exports. The quality then became the focus point of the company as soon as they realized their growth rate of the company in the foreign market. Superior quality and international standard generate an ever-rising demand for the company’s product in the foreign market. As the customers need more and more quality products so the company produced the products according to the needs of their customers. This was helping the company in holding a firm grip in the foreign export market. PRAGATI SHARMA
  • 141.
    AARTI INDUSTRIES LIMITED This year the exports of AARTI INDUSTRIES LIMITED has increased from Rs. 255.04 crores to Rs. 341.61 crores (inclusive of export through trading house and relevant export benefits) registering the growth of 33.94%. The constant effort is being made to increase the exports. The AARTI INDUSTRIES LIMITED has been awarded “STAR EXPORTER AWARD” for the year 2004-05 by the “Gujarat Dyestuffs Manufacturers Association” for the highest foreign exchange from Direct Export of self Manufactured Dyes and Dyes Intermediates. AARTI’S exports are represented by way of the following chart. As we can see in the above graph that AARTI INDUSTRIES LIMITED is exporting most of its goods to Europe. It is because European countries have stopped the production of the chemical products in most of the parts of the country due to the environmental reasons. As even they need chemical in make of certain products and that the chemical production is banned in the country for this reason AARTI INDUSTRIES LIMITED is going for most or major export of its products in the European and the African countries. PRAGATI SHARMA
  • 142.
    AARTI INDUSTRIES LIMITED The AARTI INDUSTRIES have associated with a subsidiary company, Alchemie Europe, in the UK, and have representation in the USA to provide better services to our overseas customers. ALCHEMIE EUREOPE LIMITED 7-9, ST. MARY’S PALACE, BURY LANES, BL9 ODZ, ENGLAND. TEL: + 44-161-763-1624 FAX: +44-161-763-1621 Now AARTI INDUSTRIES LIMITED is inexorably working towards the setting up of the delivery points in their strategic location so as to cater its customer with all the quality products, services, comforts etc. by reaching to the customers and provide them with what ever they need and satisfy them in the shortest possible time to reduce the wastage of time and cost involved. The products that are to be exported to the different countries are as follows. Name of the products that are exported by the AIL. (These products are similar products that are marketed in India) • Para Nitro Chloro Benzene (PNCB) • Ortho Nitro Chloro Benzne (ONCB) • 2:4 Dinitro Chloro Benzene (DNCB) • Para Dichloro Benzene (PDCB) • Ortho Dichloro Benzene (ODCB) • Nitro Benzene • Alkylated Anilines & Toluidines • Chloro Phenols • Fluoro Compounds PRAGATI SHARMA
  • 143.
    AARTI INDUSTRIES LIMITED • Agrochemicals • Other Major Products o Bulk Drug Intermediates / Speciality Chemicals o Bulk Pharmaceuticals o Bulk Drugs under R & D o Dyes These are the above chemical products which are exported by the AIL to the different countries these countries are as follows:- • United States of America, • Germany, • Italy, • Belgium, • Japan, • United Kingdom, • Spain, • Switzerland and • Korea. The AIL has set up its own Alchemic plant in United Stated of America and United Kingdom also so as to endow with better service to its North American and European Markets also that the manufactured goods is delivered to their customers on time and they do not have to linger too long for the delivery of the product and also the expenditure and time is not worn out. PRAGATI SHARMA
  • 144.
    AARTI INDUSTRIES LIMITED With the increasing globalization and the trade among the countries, the company i.e. the AARTI INDUSTRIES LIMITED is well geared to make its way into the worlds market and establish its presence among them all. PROMOTION: The AARTI INDUSTRIES LIMITED has no promotion policy. The AARTI INDUSTRIES LIMITED does not go for any promotion of their chemical products. The AIL is a specialty chemical manufacturer so the consumers know that where and whom to contact directly. And the consumers directly contact the AIL. The advertisement is given just for the complement purpose not for the promotion purpose. Few ways of promotion done by the AARTI INDUSTRIES LIMITED is by the following ways. • The AIL gives promotion in the business magazines. E.g. the publishing directory of VIA (Vapi Industrial Association). The complementary advertisement is also for some Educational Institutions if needed or necessary. • The AIL gives the newspapers. If the newspaper people approach them personally asking for the advertisements then only the AIL gives the advertisement that too complementary PRAGATI SHARMA
  • 145.
    AARTI INDUSTRIES LIMITED PACKAING, LABELLING, WARRANTIES AND GUARANTEES. PACKAGING The packaging is considered as the “fifth P” along with the product, price, place and promotion. How you present the product is felt to be of more importance. If a product has a good packaging then the customers would be attracted towards the product as sometimes the outer looks of the product also matters. As now days the world has become a show business if the thing you present is in a systematic and attractive way then it will be accepted with open hand and there is no doubt in this stanza. When we talk about the product packaging of the AARTI INDUSTRIES LIMITED, are of two forms they are • Solid form (powder form) and • Liquid form. So for both of these forms different kind of packaging is required. AARTI INDUSTRIES LIMITED does the packaging according to the need and the demand of the customers. The company manages to give the products (chemicals) the kind of packaging that matches the products characteristic and its adjustability with the plastic as most of the chemicals are packaged with the plastic. And if the chemical does not meet the characteristic of the plastic then the packaging material is coated with something else that can adjust the chemical concentration e.g. Tanker. PRAGATI SHARMA
  • 146.
    AARTI INDUSTRIES LIMITED AIL is transporting its liquid chemical in the local market in the tankers. But if the tanker has the features and the characteristic that does not match with some chemicals so for that reason the company has come up with solutions that the tanker is coated with the glass inside so that the chemical concentration does not react with the tanker and cause any hazard. Solid form (powder form) In AARTI INDUSTRIES LIMITED the chemicals are also in the solid form which is then converted in the small crystals like sugar for the customers. These solid crystals are mostly packaged in the white plastic gunny bags. These bags are for the local market as well as for the export purpose also. The plastic gunny bags minimum size is 50 kg and this is mostly used for the local market packaging and the demand of the customers. For the export purpose he plastic gunny bags are only used but the size of the gunny bag differs. The size turns to be 500 kg when it is sent to the foreign customers. This bag has such characteristic which matches the chemicals that are filled in the bags. Liquid form In AARTI INDUSTRIES LIMITED the liquid chemicals are mostly sent in big containers. These containers are packed in such a way that the chemical does not react with the drums. These drums are of different sizes and he drums are made PRAGATI SHARMA
  • 147.
    AARTI INDUSTRIES LIMITED of such material which can bear the highly chemical characteristic so that there is no hazard caused and the chemical reaches the customers safely. Even the drums might be of that characteristic which does not match the characteristic of the chemical so in that case the drums are covered with the metal of construction according to the physical characteristic of the chemical. So the plastic containers are coated inside it with the material which does not react with the chemicals. The transport people keep it when the truck-tanker is used for sending the chemicals in the local market. LABELING The labeling is done by the company in a most simplest and understandable way. As the labeling is simple the workers also understand it properly and so the chances of damage of any hazard is reduced and the danger is reduced. Format of the labeling that is done on the gunny bags which are sent to the customers by the company. The format of labeling of the domestic and the foreign market that are on the gunny bags are the same with few more additions done in the foreign bags format. PRAGATI SHARMA
  • 148.
    AARTI INDUSTRIES LIMITED PARA NITRO CHLORO BENZENE LOT NO: _____________________________________________ GROSS WEIGHT: _____________________________________ TARE WEIGHT: ______________________________________ NET WEIGHT: ________________________________________ BAG NO: ______________________________________________ AARTI INDUSTRIES LIMITED MADE IN INDIA USE NO HOOKS PRAGATI SHARMA
  • 149.
    AARTI INDUSTRIES LIMITED In AARTI INDUSTRIES LIMITED the labeling which is done on the gunny bags are also done on the drums in which the liquid chemical is being filled or sending it to the customers. NAME OF THE CHEMICAL LOT NO: ____________________ GROSS WEIGHT: ____________ TARE WEIGHT: _____________ NET WEIGHT: _______________ BAG NO: ____________________ AARTI INDUSTRIES LIMITED MADE IN INDIA HIGHLY POISONOUS PRAGATI SHARMA
  • 150.
    AARTI INDUSTRIES LIMITED The above diagram is of the drum for the liquid chemical where in such information are written such as: The lot number: The lot number is there which means that the drum is containing the chemical whose lot number is suppose 56 so that if there is any problem in the chemical than the lot number will help in knowing that whether the whole lot is spoiled or only that particular drum is spoiled. Gross weight: Gross weight means the weight of the chemical, whether in solid or liquid forms that is kept in the gunny bags or the drums. Tare weight: Tare weight is the weight of the gunny bag or the drum in which the chemical is being filled for transportation. Net weight: Net weight is the sum of the gross weight and the tare weight. Bag number: The bag number is given to each and every bag. If the lot of the chemical is spoiled then for knowing that in a particular lot which bag is spoiled and easy to see that whether the whole lot is spoiled or only that particular bag or drum is spoiled WARRENTIES & GUARANTEES: PRAGATI SHARMA
  • 151.
    AARTI INDUSTRIES LIMITED As AARTI INDUSTRIES LIMITED is a chemical producing company they do not give any warranties and the guarantees as the chemicals of AIL are of the finest quality produced and offered to the customers. THE DISTRIBUTION CHANNEL OF AIL The distribution channel of AARTI INDUSTRIES LIMITED is very short and simple. The VAPI plant manufactures the product. The marketing department MUMBAI gives the order that they have receive to the VAPI branch. The VAPI branch then sends the product i.e. the chemicals to the customers as per the orders given by the marketing department MUMBAI about the customers who have given orders and are located in the different parts of the country. MANUFACTURER SALES MENS CUSTOMERS The AARTI INDUSTRIES LIMITED make the chemical which are specialty manufactured so there is no third party the customers directly contact AARTI INDUSTRIES LIMITED. The distribution channel of AIL also consist of the sales man’s who move on to the different parts of the country and they give samples of their product to the companies and the companies they use those products (chemical) and observe that the product is having all the things which they want PRAGATI SHARMA
  • 152.
    AARTI INDUSTRIES LIMITED also with excellent quality and if they get it, they do purchase the products. There is no third party, agent or any distributors of the company. MODE OF TRANSPORTATION The mode of transportation of the Aarti Industries Limited, differ for the local as well as the foreign market. The Local Market The transportation mode in the local or home market is basically roadways as the means i.e. trucks and attached tankers on them. The chemical in the liquid form is sent by tankers in the local market. Also sometimes the liquid chemicals are transported in the drums. Whereas for the solid form the company uses normal trucks in which the chemicals are stored in the gunny bags. The Export Market For the export market the big containers are used and in those containers the chemicals are stored. The solid chemicals are kept in the gunny bags and the liquid chemicals are stored in the drums and the solid and the liquid chemicals are kept in the big rectangle containers and they are set for the exporting the chemicals. The mode of transport while exporting is the sea ways i.e. shipping. PRAGATI SHARMA
  • 153.
    AARTI INDUSTRIES LIMITED The chemicals from the company move on in a truck till the dock and from the dock it is shipped. Gunny Bags PRAGATI SHARMA
  • 154.
    AARTI INDUSTRIES LIMITED DISPATCH DEPARTMENT PRAGATI SHARMA
  • 155.
    AARTI INDUSTRIES LIMITED The AARTI CHEMICALS have a systematic dispatch department. The total numbers of people working in the department are 8 and all are in the same post. The marketing department MUMBAI gives the order to the dispatch department VAPI. The channel flow of the Dispatch Department. MUMBAI OFFICE The Mumbai office gives the order to the Dispatch department Vapi. DISPATCH DEPARTMENT PRODUCTION DEPARTMENT DISPATCH DEPARTMENT The Mumbai office gives the order to the dispatch department which is in Vapi. The dispatch department then confirms the production department whether they have the products already made in the stocks or not. If the product is ready (produced previously and kept) then the dispatch department takes the ready products from the department and directly dispatches the products i.e. chemicals on the very same day is sent. The dispatch department PRAGATI SHARMA
  • 156.
    AARTI INDUSTRIES LIMITED gives the order which is to be sent to the customers, to the production department so that the chemicals are produced before 5 days of the date of dispatching the order so that there is no delay in the sending of the order and that the company’s reputation of delivering the products on time is saved and maintained. Such are the containers which are used for the export purpose these containers contain the drums in such a way there is no space left and the drums in the containers cannot move accidents are so the chances of accidents are reduced. The same is in the case of the gunny bags. When the product is sent to the customers for the delivery at that time the company i.e. the dispatch department gives the truck driver a memo. In that memo there are some information’s which are to be feeded by the company as well as the customers to which the product is been sent for the delivery purpose. PRAGATI SHARMA
  • 157.
    AARTI INDUSTRIES LIMITED The memo consists of the information’s such as: • The date of delivery. • The customers name and address, (To whom the product is being delivered) • What the product is? • The quantity of the product. • Memo number. • Number of the truck on which the product is sent. • The sign of the person who has taken the product. • Sign of the person who has received the product. These information’s help when there is any problem or misunderstanding that has arise due to anything for that purpose he company keeps an account of such kind of information’s. The memo which is sent has minimum 4 copies. These copies are issued by the company itself and for the people like: • The main copy for the company itself • Other copy for the customer • Other for the tax and excise department and • Office use i.e. dispatch department. (As per the company’s rule) PRAGATI SHARMA
  • 158.
  • 159.
    AARTI INDUSTRIES LIMITED PRODUCTION DEPARTMENT MANUFACTURING FACILITIES AARTI has two API manufacturing plants located at Dombivli and Tarapur in Maharashtra with total area of about 15000 sq mts, and a reactor volume of more than 70 M3. The production facility at Dombivli has been designed to meet WHO GMP standards and Tarapur facility to be commissioned in January of 2005 will be US FDA compliant. AARTI INDUSTRIES plants have Stainless Steel and Glass-lined Reactors ranging from 50L to 3000L capacity. The finishing areas have appropriate air handling system with terminal filters as required. The process water is designed to meet USP requirements. Our plant facilities are equipped with multi-mills, micromeshes etc. that provide products with particle size and bulk density as required by customers. ANTI-HYPERTENSIVE  CILAZAPRIL PRAGATI SHARMA
  • 160.
    AARTI INDUSTRIES LIMITED  MOEXIPRIL  ISRADIPINE ANTI-PARKINSONIAN  PRAMIPEXOLE  ROPINIROLE  ENTACAPONE ANTI-ASTHMATIC  MOMETASONE ANTI-ACNE  ADAPALENE MACHINE AND EQUIPMENTS The following are the machine and equipments which are used in the AIL:  Storage tanks  Reactors vessel  Distillation columns  Condensers  Pumps  Absorber  Scrubber  Boiler Boiler is equipment in which steam is produced from water in an economical way i.e. by using cheap but high calorific value fuel. Steam is required in most of the chemical manufacturing processes. PRAGATI SHARMA
  • 161.
    AARTI INDUSTRIES LIMITED Types of Boiler: Depending upon the type of fuel used for steam generation the boilers are divided into different types.  Coal fired boiler  Oil fired boiler  Agro waste fired boiler In AIL the steam of 24 kg/cm^2 is generated from oil and coal fired boiler. There are two (18 and 13TPH) coal fired boiler and one (10 TPH) oil fired boiler. PLANT LAYOUT Layout:- Layout refers to the systematic arrangement of facilities in a particular work. As plant layout is an overall arrangement of the production process. Store room, stock room, material handling equipment, employee services & all other accessories required for facilitating the production in the factory. It is a Master Blue Print for co- coordinating all operation performed inside the factory. The same is we will see of he AARTI INDUSTRIES LIMITED. How AARTI INDUSTRIES has managed to arrange the layout of their company and their company’s layout has helped them to make their work very efficient while doing. PRAGATI SHARMA
  • 162.
    AARTI INDUSTRIES LIMITED OBJECTIVES OF PLANT LAYOUT  To minimize handling and transportation of material  To ensure economic utilization of available floor space.  To ensure efficient control over the various processes of production.  To minimize cost of production.  To maximize convenience and safety of the workers. PLANT LAYOUT SSP Back Security Fire Fighting Boiler Pump Water ACID PLANT House Reservoir DMS SECTION Plant Ammonia Storage 3.4 DCNB PNCB Tank Distillation Flaking ETP Section Section HCL Storage 2, 5- 3, 4- OPDA Safety DCNB DCNB Plant Dept. MCB Plant 95% PNCB DG Crystallization Section CN Crystallizatio Distillation Acid Storage Section n Section Section MCB Acid Storage PRAGATI SHARMA Storage Tanks NCB Plant
  • 163.
    AARTI INDUSTRIES LIMITED Canteen Administratio Inst. Liq. PNCB n Bldg. Secti Storage on OHC Car Garden Security Parkin g Bicycle Parking GIDC ROAD Types of plant layout Mainly there are few types of layout that are given below.  Process layout  Product layout  Fixed Position layout  Combined layout In AARTI INDUSTRY the company follows a combined layout. The combined layout is relevance of the product layout, process layout or fixed location layout and their firm meaning is difficult to know. As in the most of the industries and the companies the combination of the product layout and process layout is noticed. It is possible to have both types of layout in an efficiently combined form. PRAGATI SHARMA
  • 164.
    AARTI INDUSTRIES LIMITED As AARTI INDUSTRY is producing chemical product, they are applying combination of both product layout and process layout because the machineries from which they are producing chemical are arranged in accordance to their product and the way it is to be processed. MATERIAL HANDELING SYSTEM It involves the movement of material from one place to another for the purpose of processing. The material handling equipments are as follows  Cranes  Industrial trucks  Pipe lines.  Pallet.  Fork lifts truck. PRODUCTION PROCESS Raw material The company manufacture its products from the basic raw material-benzene and sulphuric. The other major raw materials are chlorine nitric acid, ammonia, caustic soda, and methanol. All these raw material are available freely in sufficient quantity in the local and international markets. The major suppliers of this raw material are:- • Reliance industries ltd. • Bharat petroleum corporation ltd. • National organic chemical Industries ltd. • Standard albalies ltd. PRAGATI SHARMA
  • 165.
    AARTI INDUSTRIES LIMITED • National rayon corporation ltd. • Grasim industries. • Gujarat Narmada Valley Industries corporation. • Deepak Nitrate ltd. • Transport ltd Dubai. • Helm chemicals Germany • Universal chemical Bahrain. Raw material Purity Mono chlorobenzene 99.99% Nitric acid 98% Sulphuric acid 98% Spent Acid 72% (Part of sulphuric acid) PRODUCTION PROCESS: NITRATOR SEPARATOR WASHER SEPARATOR SPENT WATER ACID NCB MCB, MIX ACID, STORAGE NITRIC ACID TANK DRYER ETP P CUT PRAGATI SHARMA
  • 166.
    AARTI INDUSTRIES LIMITED DISTILLATION CRYSTALLIZATION STORAGE TANK NCB ML PURE PURE ONCB PNCB PRODUCTION PROCESS: Raw material like monochloro benzene, nitric acid, Sulphuric acid, spent acid (part of Sulphuric acid) are brought in the plant and before they get into further process there is tight quality check on it, it eh material is in proper form then it is sent to the plant for further proper form then it is sent to the plant for further processing. In the plant the raw materials are brought together in a nitrator, in the nitrator mono chloro benzene is then mixed acid and nitric acid. Then this mixture is further sent to the separator through pipes as it is in liquid form. Through separator NCB is obtained which floats above spent acid sediment down. The NCB is now sent to PRAGATI SHARMA
  • 167.
    AARTI INDUSTRIES LIMITED washer and spent acid is sent to storage tank. The washer machine is filled with water in which NCB is washer and separated. From this the water is sent to ETP. NCB is sent to dryer machine for drying the remaining water. From dryer machine NCB is sent to storage tank. NCB is now ready for crystallization process. Through crystallization process pure PNCB is obtained. ML is also obtained which is sent for distillation process. Through this pure ONCB is obtained. P-cut is also obtained which is again sent for crystallization process. From the above process NCB, PNCB, ONCB are obtained. These are in liquid form when produced. According to customer’s preference they are converted into flake form or powder form as a required. Acid section In turbine there is Sulphate acid which is pumped with dry air latter it is burning up to 90 c along with putting SO2 it then moved to WHB and putting water in it and it is converted in to 420c and go in the form of stem to the converter 1 bed. After this process we get SO3. Remaining portion is moving in to SH for the purpose of heating and it shift to converter 2nd bed and finally moved into HHE for the purpose of making cooling and some potion Goggles back to HHE and remaining portion shifted into SO3 generator 1st and 2nd. Then it is moving into OT 1st and 2nd for the purpose of mixing and during this process we get some portion of 23% and remaining portion shifted into absorption tower and during this process some portion is go back to CHE. In absorption tower sufficient arrangement so that 98% H2sO4. We can procure and it shifted into converter 4th bed. In this converter some portion of H2so4 coming from HHE and further it moved into economizer and we get finish product SO3 and remain portion in the form of gas moved into final PRAGATI SHARMA
  • 168.
    AARTI INDUSTRIES LIMITED absorption tower for purpose of making 98% H2SO4. Then it further moved into mix exchanger in form of gas and finally in the form of gas gone out by chimney. USES • Manufacturing of fertilizer, heavy chemical, coal tar product, dyes, plastic, paints, and pigment. • Explosive, textile, inorganic fertilizer like super phosphate, sulphates, etc. • In metal processing use for pickling of steel, in purification of petroleum product. • Pharmaceuticals, making of alcohols, detergent, insecticides, and herbicides. • In food industry in manufacturing of starch syrups and other products. • In transfer of lead accumulators or batteries are used. PRODUCT PROFILE 1) BENZENE BASED INTERMEDIATES AARTI is amongst the largest manufacturer of Benzene based intermediates in India with products classified into the following categories:  CHLORINATION of Benzene into MCB, ODCB, PDCB & TCB. AARTI presently has a chlorination capacity of 70,000 tons per annum - Largest in India.  NITRATION of MCB into PNCB, ONCB and Dinitration to 2:4 Dinitro  Chloro Benzene with a capacity of 90,000 tons per annum - Largest in India. PRAGATI SHARMA
  • 169.
    AARTI INDUSTRIES LIMITED  AMMONOLYSIS of Nitro Chloro compounds such as PNCB, ONCB, 2:5 DCNB and 3:4 DCNB in a high pressure batch (autoclave) process. AARTI is the largest manufacturer of Amination products in India and is making various amino compounds such as PNA, ONA, OCPNA, PCONA, etc.  REDUCTION of various Nitro compounds such as PNCB, ONCB, MNCB, ONA, PNA, MDNB, 2:5 DCNB and 3:4 DCNB mainly by catalytic Hydrogenation to PCA, OCA, MCA, OPDA, PPDA, MPDA, 2:5 DCA & 3:4 DCA respectively. AARTI presently has a reduction capacity of 20,000 tons per annum  SULPHONATION, METHOXYLATION, CONDENSATION & FLUORINATION products are also a part of AARTI's range.  ACETYLATION & other chemical reaction facilities to manufacture various derivatives which are mainly used in Dyes & Pigments. 2) SULPHURIC ACID & IT'S ALLIED PRODUCTS.  AARTI's SULPHURIC ACID PLANT has a capacity of 1, 75,000 tons per annum where, in addition of 98% Sulphuric Acid, AARTI also manufactures OLEUMS, SULPHUR TRIOXIDE & CHLORO SULPHONIC ACID.  AARTI has most backward integrated plant for DIMETHYL SULPHATE (the key methylating agent) i.e. starting from Sulphur & Methanol. PRAGATI SHARMA
  • 170.
    AARTI INDUSTRIES LIMITED 3) BULK PHARMACEUTICALS: AARTI is making various Bulk Pharmaceuticals in the range of Antidiarrhoeals, Antiinflammatory, Vitamins, Antiasthama, Anti HIV, Antijetlag / Sleep Disorder, Ace Inhibitor, Antibiotics & Antidiabetics. 4) AGROCHEMICALS: These comprise of Quinalphos & Carbendazim. 5) DYES:  AARTI has started getting dyes manufactured on contract basis from the local manufacturers exclusively for exports.  The AIL have a well equipped quality control laboratory at MUMBAI with sophisticated equipments like: o Gas Chromatography Machine, UV/LR Spectrophotometer, Potentiometric Titration equipments, HPTLC, High Pressure Rotta Dyer. o We are now able to supply chromium free dyes in powder & liquid form for Swimming Pool & Spa applications. o We supply liquid dyes in Eco friendly packing of IBC Tunner & powder in biodegradable corrugated boxes. PRAGATI SHARMA
  • 171.
    AARTI INDUSTRIES LIMITED 6) OTHER INTERMEDIATES & SPECIALITY CHEMICALS:  Alkylated Amines and toluidiness,  Chlorophenols,  Fluoro Compounds,  Other specialty chemicals. ORTHO NITRO CHLORO BENZENE Product Details 2- Chloro Nitro Benzene (Ortho Nitro Chloro Chemical Name Benzene) (88-73-3) Chemical Formula C6H4NO2CL Molecular Formula CAS No. 88-73-3 PRAGATI SHARMA
  • 172.
    AARTI INDUSTRIES LIMITED Molecular Weight 157.5 Appearence LIGHT YELLOW LIQUID Moisture 1000 PPM MAX. Set point 31.7°C MIN Purity by GC 99.65 % Min. DYESTUFF & DYESTUFF INTERMEDIATES End Use PHARMA & PHARMA INTERMEDIATES AGROCHEMICAL INTERMEDIATES SPECIALITY CHEMICALS DINITRO CHLORO BENZENE Product Details Chemical Name 2,4 Dinitro Chloro Benzene (97-00-7) Chemical Formula C6H3(NO2)2Cl PRAGATI SHARMA
  • 173.
    AARTI INDUSTRIES LIMITED Molecular Formula CAS No. 97-00-7 Molecular Weight 202.5 Appearence Pale Yellow to Reddish PH 6.5 to 8.0 Typical impuriy Insolubles: 0.2 % Max. Moisture 0.2 % Max. Set point 48.5 oC to 49.5 oC Purity by GC 99.0 % Min. End Use DYESTUFF & DYESTUFF INTERMEDIATES PARA DICHLORO BENZENE Product Details 1,4 Dichloro Benzene (Para Dichloro Benzene) Chemical Name (106-46-7) Chemical Formula C6H4Cl2 PRAGATI SHARMA
  • 174.
    AARTI INDUSTRIES LIMITED Molecular Formula CAS No. 106-46-7 Molecular Weight 147 Appearence Colourless liquid Moisture 1000 ppm Max. Set point 52.5 °C MIN Purity by GC 99.75 % Min. End Use DYESTUFF & DYESTUFF INTERMEDIATES PHARMA & PHARMA ORTHO DICHLORO BENZENE Product details 1,2 Dichloro Benzene (Ortho Dichloro Benzene) Chemical Name (95-50-1) Chemical Formula C6H4Cl2 PRAGATI SHARMA
  • 175.
    AARTI INDUSTRIES LIMITED Molecular Formula CAS No. 95-50-1 Molecular Weight 147 Appearence Colourless liquid Purity by GC 99.75 % Min. DYESTUFF & DYESTUFF End Use INTERMEDIATES AGROCHEMICAL INTERMEDIATES SPECIALITY CHEMICALS NITRO BENZEN Product details Chemical Name Nitro Benzene (98-95-3) Chemical Formula C6H5NO2 Molecular Formula PRAGATI SHARMA
  • 176.
    AARTI INDUSTRIES LIMITED CAS No. 98-95-3 Specification IBP : 208 oC to 210 oC Molecular Weight 123.11 Appearence Colourless liquid in Aniline Melting Point 5.2 oC Boiling Point 210 oC to 211 oC DNB content : 0.02 % to 0.03 % Max.,Others : Typical impuriy 0.67 % to 0.68 % Form and Net Weight Tanker load End Use DYESTUFF & DYESTUFF INTERMEDIATES AGROCHEMICAL INTERMEDIATES Product Details Chemical Name 4-Chloro Phenol (PCP) Chemical Formula C6H5ClO Molecular Formula CAS No. 106-48-9 Molecular Weight 128.5 Appearence White Yellowish crystalline / fused Odour Phenolic odour Di Chloro Phenol, Phenol,2-Chloro Phenol & Typical impuriy Others :Less than 1 % Form and Net Weight 250 kgs. : M.S. Drums DYESTUFF & DYESTUFF INTERMEDIATES End Use AGROCHEMICAL INTERMEDIATES SPECIALITY CHEMICALS PARA NITRO CHLORO BENZENE Product Detail Chemical Name 4 - Chloro Nitro Benzene (Para Nitro Chloro Benzene) (100-00-5) Chemical Formula C6H4ClNO2 PRAGATI SHARMA
  • 177.
    AARTI INDUSTRIES LIMITED Molecular Formula CAS No. 100-00-5. Molecular Weight 157.5 Appearance Light yellow to yellow flakes Typical impuriy ONCB:0.50% MAX 1000 ppm Max.(Flakes) & 1500 ppm Moisture Max (Liquid) Set point 82.2 °C Min. (Flakes) & 81.0 °C (Liquid) Purity by GC 99.50% Min. Packaging 250 kg Steel Drum / 18 MT FCL DYESTUFF & DYESTUFF INTERMEDIATES PHARMA & End Use PHARMA INTERMEDIATES PIGMENT INTERMEDIATES AGROCHEMICAL INTERMEDIATES PRAGATI SHARMA
  • 178.
  • 179.
    AARTI INDUSTRIES LIMITED QUALITYCONTROL AND RESEARCH & DEVELOPMENT Quality:- Quality is the totality of the features and the characteristics of a product or services that bear on its ability to satisfy the stated or implied needs of the customer. Quality is the sum of the attributes that describes the product. According to the AIL, the objectives of quality are listed below. Being a chemical company, consumers may not be directly using AIL's products, and it may be difficult to see how the chemicals they produce enrich the lives of people. But the AIL do contribute towards improving the people’s quality of life since the end users of our products are industries ranging from agrochemicals and dyes to speciality chemicals and pharmaceuticals - markets that are critical to long-term sustainability. By supplying high quality and good value products to our PRAGATI SHARMA
  • 180.
    AARTI INDUSTRIES LIMITED customers, we indirectly help people to have access to better medicines, fertilizers and diverse items of daily use. In other words, greening the supply chain management plays a significant role in our business strategy. Objective of Quality AARTI INDUSTRIES is expert in producing (chemicals) a product with a world class quality. As for AIL their customers play a significant role in their development in the same way for their customers the quality plays a significant role so the AIL observes that their product is of the most excellent quality and that their customers are greatest satisfied with the quality of their product (chemicals). The objectives of AIL are as follows.  To satisfy the consumer.  To reduce the cost.  To improve the income.  To increase the productivity. AARTI INDUSTRIES LIMITED has proficiency in developing or innovating new products & processes that have world class quality. AARTI INDUSTRIES LIMITED carries on research in various areas and that too with a special emphasis on pharmaceutical intermediates, Agro intermediates, pharmaceuticals, Agrochemicals & specialty chemicals. QUALITY POLICY PRAGATI SHARMA
  • 181.
    AARTI INDUSTRIES LIMITED Good health cannot be achieved without quality products and quality manufacturing facilities. We meet all the pharmacopoeias requirements, industry standards and laws that govern manufacture of APIs & Intermediates. Our Research facilities and plants are designed to meet world-class standards. Our processes are will established and have properly documented quality management systems as per c-GMP guidelines. Our Quality Assurance ensures quality requirements, systems and procedures to meet c-GMP norms. A periodic training facility to people ensures compliance of GMP needs. QUALITY CONTROL The products quality is influenced at various stages of design, production, storage, sale, use etc and as design is not in consideration in the AARTI INDUSTRIES so for them this is excluded from the rest and the rest should be considered very carefully. For quality control the AARTI INDUSTRIES are checking the quality of the product in the following ways.  The AARTI INDUSTRIES LIMITED checks the quality of the raw- material before receiving that raw-material from their suppliers.  The AARTI INDUSTRIES LIMITED verifies the raw-material received from their suppliers in the laboratory whether that material is of quality or not. PRAGATI SHARMA
  • 182.
    AARTI INDUSTRIES LIMITED  The AARTI INDUSTRIES LIMITED also inspects the quality of the product in between of the production process to confirm the quality of the product.  The AARTI INDUSTRIES LIMITED examines the product’s quality at the end of the production process to ensure the best quality of their product (chemicals). Thus in this way the AARTI INDUSTRIES LIMITED is controlling the quality of their product. They are examining that whether the quality of their product is meeting the customer’s essential criteria and needs or not. QUALITY MANAGEMENT SYSTEMS:- AARTI INDUSTRIES LIMITED is and ISO 9001-2000. Quality assurance: The AIL is a company which is able to provide a mass goods of uniform quality. AIL also follows the quality policy according to which it had obtained ISO-9001, 2000 version certificate (obtained from TUV). Quality policy:- AIL leading manufacturer of intermediates and specialty chemicals is committed to provide quality products and services leading to total customer satisfaction while conducting business. We shall strive to continually improve PRAGATI SHARMA
  • 183.
    AARTI INDUSTRIES LIMITED performance, process and system with and aim to be world class in terms of productivity, safety, occupational health and environmental performance by harnessing the competence of employees and ensuring their involvement. Tools used to maintain the quality: AIL is using various tools to control the quality standards. These are HPLC: High pressure liquid chromatography GLC: Gas liquid chromatography DCS: Digital Control System scrapin AARTI INDUSTRIES LIMITED has an expertise in developing or innovating new products and processes that have world-class quality. AARTI INDUSTRIES LIMITED is doing Research in their own unit, in various areas with special emphasis on Pharmaceutical Intermediates, Agro Intermediates, Pharmaceuticals, Agrochemicals and Specialty Chemicals. AARTI INDUSTRIES LIMITED has fully equipped laboratory with high- tech advanced instruments and highly qualified technical personnel at their R & D centers. AARTI’s advanced Analytical Instruments includes the following: Gas Chromatograph & HPLC Digital Polarimeter Auto Titrator Digital Melting Point Instrument UV Visible Spectrophotometer FTIR Spectrophotometer AARTI at its Pilot Plant facility has R & D Process Equipments like: PRAGATI SHARMA
  • 184.
    AARTI INDUSTRIES LIMITED Glass Reaction Equipment Glass Lined Reactors High Pressure Autoclave SS 316 Reactors Distillation Equipment Centrifuges Sparkler Filter Air Handling Systems AARTI's pharmaceutical plants are GMP (goods manufacturing practices) approved and some of the plants have got ISO 9002 Certification also. PRAGATI SHARMA
  • 185.
  • 186.
    AARTI INDUSTRIES LIMITED RESEARCH & DEVELOPMENT AARTI INUSTRIES LIMITED has fully equipped laboratory with high-tech advanced instruments & highly qualified technical personnel at its R&D centers that help the AIL to make the product which is of the paramount quality which also helps the AIL to cater the number of customers for themselves with the maximum number of the market share and place the AARTI INDUSTRIES LIMITED among the top most chemical manufacturing products in the world. The AARTI INDUSTRIES LIMITED has four state-of-the-art R & D centers, recognized by DSIR (Dept. of Scientific & Industrial Research), Government of India, which carry out innovative product and process development work with special emphasis on pharmaceuticals and speciality chemicals. The advanced Analytical instruments of AARTI INDUSTRIES LIMITED include: PRAGATI SHARMA
  • 187.
    AARTI INDUSTRIES LIMITED Centrifuges Gas chromatograph & HPLC Distillation equipment 4Digital Polarimeter Glass Reaction equipment Sparkler filter Air handling system Auto Titrator FTIR spectrophotometer Glasslined Reactors Uv visible spectrophotometer High pressure Auticlave Digital melting point instrument AARTI`s pharmaceutical plant are GMP approved & some of the plants have got ISO 9002 certificate. • Areas in which R&D carried out by the company: The R&D activities are carried out by the company in the areas of  Bulk and pharmaceuticals formulations,  Specialty chemicals and  Intermediate chemicals. • Advantage from R&D: PRAGATI SHARMA
  • 188.
    AARTI INDUSTRIES LIMITED The R&D centers of AARTI INDUSTRIES LIMITED at Vapi are showing satisfactory progress in their development of new products and improvement in existing product efficiencies. • Future plan of action: The AARTI INDUSTRIES LIMITED will maintain its R&D activities and the innovation and development of new products and improvements in existing product efficiencies. • The company has incurred the following expenditure in research and development. In the areas of new products and improvement in existing products efficiencies. Expenditure on R&D (Rs. In lakhs) • Capital 131.91 • Recurring 56.51 • Total 188.42 • Total R&D expenditure as a percentage of total turn over -0.27% PRAGATI SHARMA
  • 189.
  • 190.
    AARTI INDUSTRIES LIMITED STORES DEPARTMENT  Engineering goods Small parts In alphabetical order Given the code to each part LIFO method for engineering goods. Raw material of the chemicals  Chlorine  Nitric acid  Benzene  Methane Controlling of waste:  Resale in the market  As a fertilizer NCB MCB PNCB PRAGATI SHARMA
  • 191.
    AARTI INDUSTRIES LIMITED ONCB Refinery process COMPONENTS IN THE ENGINEERING STORE • Nut and Bolt • Hose Nipple • V belt • Hex Nipple • Gland Thread Pump • Flange • Copper Tube • Needle Valve • Impeller Pump • Ss Valve short/long • Compressor • Blend • Stainless Steel Pipe • Steam Trap IVR • Float Valve • Shed Glass • Siphon Tube • Cf bag • Metallic Hose Pipe • Filter Bag • Compressor • Joining Gasket • Oil seal for gear box in Reactor • Rex Rubber PVC • Star butch • Bush Bolt Sheet • Pulley • Chalk • Gear Box • Cotton Mask • Motor Reactor • Spoon • Coupler • Disposable cap/Gloves • Teflon Gasket • Muff Ear Mask • SPO Pump • Teflon Tape • Motor • Gumboots • Valve • Goggles • HDP Fitting • Rubber/PVC Hand • Butterfly Valve • Gloves • Esteem Valve NRV • Wire Brush • Tool kit • Pump Spares • Welding Rod • Ball Bearing • Pressure Gauge • Vacuum • Water Line • Boiler/Electrical Spares PRAGATI SHARMA
  • 192.
    AARTI INDUSTRIES LIMITED STRUCTURE OF STORE DEPARTMENT STORE DEPARTMENT Raw Material Packing Engineering Store Material Store Material Store PRAGATI SHARMA
  • 193.
    AARTI INDUSTRIES LIMITED FLOW DIAGRAM OF RECIEPT OF STORE MATERIAL Receipt of material and inward entry PREPARATION OF RMR Stacking at under Physical inspection by Expert’s Person Getting Quality report in terms of approved or rejected Unloading of material in proper pattern at unloading point and verification with vendors challan Rejected material are returned to concerned vendors Approved material are kept in proper stacking for consumption as per daily requirement GRR prepared PRAGATI SHARMA
  • 194.
    AARTI INDUSTRIES LIMITED OPERETION PROCESS OF STORE DEPARTMENT VENDORS PURCHASE Purchase Order Purchase Material Requisition STORE DEPARTMENT Issue of material to plant EXCISE Modvat GRN ACCOUNT DEPARTMENT Invoice Payment PRAGATI SHARMA
  • 195.
    AARTI INDUSTRIES LIMITED FLOW DIAGRAM FOR GENERATION OF REQUIREMENT OF STORE MATERIAL Monthly Requirement of store material by the user Generation of purchase requisition Release of purchase order by the purchase department Verification of released purchase orders by store in terms of monthly requirement of user department PRAGATI SHARMA
  • 196.
  • 197.
    AARTI INDUSTRIES LIMITED PLANT UTILITY DEPARTMENT Every plant or industry or human being requires certain basic necessities without which it would be impossible to function. Necessities like water, air, energy (power) etc are just these and fall under the category called utilities. It is no wonder that the utility section is called the heart of the plant. At AARTI INDUSTRIES LIMITED, the following utilities are created and consumed such that various other plants producing various products are the major consumer of this utility. These utilities are mainly:  STEAM PRAGATI SHARMA
  • 198.
    AARTI INDUSTRIES LIMITED  High pressure  Low pressure  Medium pressure  AIR  Process air  Instrumentation air  RAW WATER  POWER  CHILLING WATER  Brine water  Steam This basic utility is created in bulk at Sulphuric acid plant and Boilers. Advantage of steam o Easily available o Relatively cheap to make o Provide a good heat transfer medium  Air A very important utility for any plant, air is basically used for two main purposes. Air used is mainly as compressed air which is created by using air compressor. The end product that is compressed air is then sent for various purposes depending on its main use. When it is used in the process it is called process air. When the compressed air is used for pneumatic purpose like Rota meters, pneumatic valves, which are directly linked to the main digital control room, it is called instrumentation air. At AIL Reciprocating air compressor is used. At AIL 350 CFM (cubic feet per minute) and 320 CFM AC is used, which are in stand by to each other. These are PRAGATI SHARMA
  • 199.
    AARTI INDUSTRIES LIMITED used for instrumentation air. There are three 100 CFM AC, out of this three, two are used for process air while the third one is used for making nitrogen gas.  Power This utility is required and is often considered as the bloodline of the plant. EXTRATION BOILER TURBINE GEARBOX GENERATOR TRANSFORMER DE AERATOR CONDENSOR TRIPPER 3 Phases The turbine rotates at RPM of 9720. While AIL supply frequency of 50 hertz. Exposing the generator to such high RPM would lead to damaging of the generator, so for this introduce a gearbox whose primary aim is to lower the RPM. Here the gearbox used is specified in terms of the ratio of the turbine blade RPM to generator RPM. In order to give out power at 50 hertz, the generator must rotate at 1500 RPM. The gearbox is operated at a ratio of 6:4 In the event that any of the major computer system fail, AIL have a back up system. The most important feature of the acid plant is revealed here. AIL operates the back up system in such a manner that the acid plant get top most priority this is done because the plant I is primarily steam producing unit which produces acid also using this steam AIL can run the diesel generator. AIL last option is to lower the load in the power plant, failing which the plant is asked to shutdown. PRAGATI SHARMA
  • 200.
    AARTI INDUSTRIES LIMITED  Raw water This utility is used mainly for the purpose of being made into steam. The largest supplier of this is the Gujarat board.  Chilled water At AIL, two kinds of chillers are used. Thus AIL have ammonia based as well as Freon-22 as refrigerant. The cooling effect is measured in terms of “tones of refrigeration” Ammonia is used as a refrigerant because of particular thermodynamic properties which enable it to move heat far more efficiently than other refrigerant gases. It is particular suited to working to in the range approximately 0-15c and hence widely used in the chemical industries as well as other industries like food preservation and chilling of milk, dairy product, beer and cold drinks. Freon22 is used when AIL need temperature of -17c. The working principle remains same. PRAGATI SHARMA
  • 201.
  • 202.
    AARTI INDUSTRIES LIMITED HEALTH AND SAFETY It is policy of AIL, Vapi to provide more suitable and endangers work to its workers. It’s also provided safety to visitor, as well as any other people. Occupational health and safety program are regularly conducted to achieve our common goal i.e. safety which has been as control of accidental loss. Emergency Exit: Provide at least two escape exit with clearly visible emergency sigh on every floor or in every room. Keep all the escape ways leading to emergency exit free from obstacles. Provide enough fire extinguisher of the appropriate type within every reach. PRAGATI SHARMA
  • 203.
    AARTI INDUSTRIES LIMITED Safety Audit The purpose of this exercise is to review all plant and their process and operation of safety requirement to identify unsafe condition and practices improve safety and health at work place to prevent accident loss. Any safety officer or team of management carries out plant wise safety audit shell at least once in month. AARTI HEALTH CARE Aarti Healthcare is US-FDA compliant.  API Division of AARTI INDUSTRIES LTD., Flagship Company of USD 189 Million “AARTI GROUP”, since 1976, exporting to more than 65 countries, including Developed and developing Markets.  API Division manufacturing APIs, in niche segments Viz: Anti – Hypertensive, Anti –Asthamatic, Anti-Cancer, Anti- Inflammatory / Anti- Allergic, Anti- Diabetic, Anti- Depressants, Anti- Thalassaemic. (Please refer to Product List).  Manufacturing Units at Dombivali & Tarapur, in Maharashtra State of India, will be WHO GMP Approved facilities by End Dec.2003.  Brand New facility upcoming at Tarapur & Vapi, per US-FDA Standard. PRAGATI SHARMA
  • 204.
    AARTI INDUSTRIES LIMITED  In house R & D Center, with Ultra modern, sophisticated Instruments, equipped with a Team of Highly skilled scientists, working round the clock on New Products and Process Improvements.  Expected to receive CoS for Ramipril, Budesonide, Venlafaxine, in year 2004, for marketing products in Western Europe.  E-DMFs in CTD Formats available for most of the commercialized molecules.  All products match specifications of BP / USP / EP, as applicable.  Esteemed clients in Domestic Market, serviced by us are, Ranbaxy, Sun Pharma, Cipla, Aristo , Astra- Zeneca Pharma India, Maral Labs., Cadila Healthcare, German Remedies, Intas, Biotrans, Dr. Reddys Laboratory (DRL)  Per individual client’s need, can also provide “Tailor Made Products” for physical parameters viz: Particle size (micronised material), Bulk Density etc., as well Impurity profile, Methods for Testing etc.  We also offer Intermediates of most of our APIs (Pl. refer to Product List).  Products under Patent will not be sold until Patent expiration in Buyer’s Country. Purchase of Patented Product will be sole responsibility of the Buyer. PRAGATI SHARMA
  • 205.
    AARTI INDUSTRIES LIMITED SAFETY DEPARTMENT Safety is essentially meant for protecting human life and property. Elimination of unsafe condition in all the operating area and prevention of unsafe practices are given importance by the top management of AIL. Structure of Safety department ASSISTANT DEPUTY MANAGER SAFETY SAFETY SAFETY ASSISTANT OFFICER INCHARGE PRAGATI SHARMA
  • 206.
    AARTI INDUSTRIES LIMITED ENGINEER SAFETY SUPERVISOR Safety slogan: Some of the safety slogans of AIL are as follows: “What is safety”? Safety means freedom from danger, security of life.  “Safety begins with me”  “Our aim zero accident.”  “Safety saves sorrow/ it offer security and beings efficiency”  “No safety know pain / know safety no pain”  “Safety needs involvement”  “Alert today tomorrow”  “Accident brings tears/safety brings cheers”  “With accident you gain / sorrow, sufficiency and pain”  “A safety rules breaker is an accident maker” PRAGATI SHARMA
  • 207.
    AARTI INDUSTRIES LIMITED  “Love is the soul of life, fragrance is the soul of flowers, and energy is the soul of flower, sage productivity.”  “No job is so important and no service is so urgent that we cannot take time, to perform or work safety, this time to do things safety can be the most important, time in our lives”  “Working to gather works, magic may be everywhere but there is no magic in safety. Just common sense.”  “Care builds carelessness burns.” Goals of safety, health and environment are:  To prevent injuries and personnel illness.  To maintain work place and surrounding area safe and healthy.  To eliminate any foreseeable occupational and environmental hazard that may result in fire and damage to property.  To ensure that the ministry of labor, health, safety and welfare regulation are fully met with. General safety awareness:  Smoking and consumption of tobacco is strictly prohibited.  Do not run or jump on ladder. PRAGATI SHARMA
  • 208.
    AARTI INDUSTRIES LIMITED  Wash hands and rinse mouth properly before eating, take bath before going home.  Don’t eat anywhere in the plant except in canteen.  All employees should wear helmet and shoes in the plant.  Don’t spill any oily substance on the floor.  Use safety belts while working on high altitudes.  Don’t repair any machine/equipments when it is operating condition.  Use flame proof lamp near M.C.B, benzene, ammonia and methanol. AIL has many “Safe Assembly Point” and under ground tank for preserving the liquid acid. AIL has 71 boundary point of fire fighting points. The safety department conducts in plant safety training program on regular basis. Chemical emergency, prevention preparedness and response. Importance and use of safety equipment (Explosive, oxygen, CL-2, HCN, Monitors, SCBA, ESA, Fire Gas Tight Suit, First Aid-Box) Use of Personal Protective Equipment. PRAGATI SHARMA
  • 209.
    AARTI INDUSTRIES LIMITED There are two type of PPE. They are  Respiratory PPEs  Non-Respiratory PPEs Respiratory PPE ö Breathing Apparatus set used while handling gas leakages. ö Canister mask used while cleaning vessels or reactor internally. ö Air supply mask used while internal cleaning of vessels ö Dust mask of protection against dust. Non-Respiratory PPE ë Helmet for protection of head. ë Ear plug/ear muff for protection against noise. ë Face seal for protection of face. ë Safety goggles for protection of eyes. ë PVC suit for protection of body and clothes. ë Hand gloves for protection of hands. ë Apron for protection of clothes. ë Welding shoes / safety shoes / gum boots for protection of legs. PRAGATI SHARMA
  • 210.
    AARTI INDUSTRIES LIMITED ë Safety belts used while working on height. Gas Leakage  Wind direction is observed by seeing wind direction indicator. It is advised to go into the transverse (90 degree) or opposite direction and reach the safe assembly point.  Only trained and persons equipped with Breathing apparatus set should go to the place of emergency.  Make way for the rescue team or first aid team or emergency vehicle.  If a person inhales gas take him to open place. Loose his clothes. Remove shoes and helmet. If he becomes unconscious, send him immediately to hospital. Chemical spillage  If there is contact with face or eyes immediately wash below safety shower for at least 15 minutes.  If chemical goes in mouth rinse properly with water.  Contact the safety department for treatment. Emergency preparedness  Water should be readily available at every point by means of fire hydrant.  Fire extinguisher should be easily accessible in every plant.  There should be wind direction indicator and siren. PRAGATI SHARMA
  • 211.
    AARTI INDUSTRIES LIMITED Accident occurrences reporting system  In case of fire a siren is blown twice at an interval of 15 seconds.  In case of gas leakage a siren is blown continuously four times for 15 seconds duration.  When situation comes under control a siren is blown for 1 minute. First aid First aid for some common accidents is as follows:  Burn  Shock  Injury or cut  Suffocation  Eye injury  Poisoning  Fracture PRAGATI SHARMA
  • 212.
    AARTI INDUSTRIES LIMITED Housekeeping  Accident because of inferior housekeeping.  Scattered thing at work place.  Things falling from above.  Wet or oily floor.  Tumbling over substances nearby.  Fire because of inflammable things and loosely connected electrical wires.  Sign of inferior housekeeping.  Heaps of garbage and waste.  Uncovered manholes.  Improper hygiene at resting place  Inadequate lighting  Oily and wet floor.  The machine with high speed is uncovered. Basis of housekeeping The management should inculcate housekeeping in every worker by impressing that with superior housekeeping the quality of the product can be improved and the factory as well as worker will progress.  Inspection list for housekeeping a) Floor b) Lighting arrangement c) Ladders PRAGATI SHARMA
  • 213.
    AARTI INDUSTRIES LIMITED d) Fire extinguisher e) Surrounding bushes and plants.  Advantage of housekeeping a) Work will be fast and safe b) Health of worker will be good. c) Workers will feel secure. d) Relation between worker and management is improved e) Quality for the product is enhanced f) Everyone will be disciplined.  Runway reaction(thermal explosion): It’s the consequences of the loss of control of the temperature of chemical compound or a reaction mixture in an enclosure.  Consequences of runway reaction:- i. It results in the emission of a two phase mixture of gas and liquid to the atmosphere giving an aerosol. ii. In open air aerosol can ignite due to oxidation of hot gases and droplets with air of possibly to the occurrences of electric sparks. iii. The emission of reaction mixture in housing area can cause serious problems.  Causes of runway reaction:- PRAGATI SHARMA
  • 214.
    AARTI INDUSTRIES LIMITED i. Any deviation from process condition. ii. Lack of experimental information necessary for risk assessment, choice of safe choices. iii. Lack of consequence of runway reactions. Types of thermal explosions:- a) Homogenous thermal explosion :- it includes  Reactor under heating condition.  Reactor under cooling condition.  Reactor under heating condition with high heat flux applied.  Other initiating agent. b) Heterogeneous thermal explosion:- it includes  Storage vessel hazards  Process deviation parameters  Fast propagating reactions SAFETY HEALTH AND ENVIRONMENT POLICY (SHE POLICY) "As a responsible organization engaged in the business of manufacturing chemicals, we, at AARTI INDUSTRIES LIMITED, Vapi, shall strive to ensure improvement in all aspects of our Safety, Health and Environment (SHE) performance related to our activities, products and services, through an effective implementation, monitoring and periodic review of the designed SHE Management System." PRAGATI SHARMA
  • 215.
    AARTI INDUSTRIES LIMITED With respect to the above, we pledge to:  Ensure continual improvement in the SHE Management System  Comply with applicable SHE legal requirements  Institutionalize effective resource management, with a specific focus on energy, water and basic raw materials  Strengthen pollution prevention & waste reduction practices and strive to provide a safe and healthy environment  Enhance SHE Management System awareness about the desirable practices to be followed by employees and other concerned stakeholders, through proper communication. PRAGATI SHARMA
  • 216.
    AARTI INDUSTRIES LIMITED SHE INITIATIVES FOR THE YEAR 2005-2006  Three new flame-proof safety torches procured.  Non-sparking tools procured.  Serial numbers provided to all welding machines.  HAZOP study and risk assessment being carried out.  Recommonded for ISO 14001 & OHSAS 18001 certification. PRAGATI SHARMA
  • 217.
    AARTI INDUSTRIES LIMITED  Specific focus on conservation and reduction in consumption of primary raw materials, energy and water.  Scrubber system for NOx & HCl modified for better efficiency.  Online Benzene sensor installed in MCB Plant.  Implemented the new hot work permit system. Started providing fire extinguisher from safety dept. to avoid misuse of plant fire extinguishers.  Air moisture removal filter installed in fresh air line in chlorine shed.  Implemented the safety work permit system for CNA and Methanol tanker unloading.  Acid spillage transfer arrangement made during emergency in Acid plant.  Emergency training imparted for dealing with cyclones.  Special training sessions organized on skin diseases, AIDS, First Aid and M.S.D.S. by inviting external experts.  Leaflets in Hindi & Gujarati language for emergency preparedness distributed to all employees.  Formulated fire-fighting and rescue squad and trained them to be ready for tackling any emergency.  Hepatitis 'B' injection given to all employees and family members.  Pre-employment medical check-up & yearly medical check-up of existing employees carried out. PRAGATI SHARMA
  • 218.
    AARTI INDUSTRIES LIMITED  Eye test of all DMS employees done. Power with photo chromic/without photo chromic lens provided to all DMS employees.  Conferring of the Best Housekeeping Award started.  World Environment Day celebrated on 5th June. GPCB members were present on this occasion.  Complied with all legal requirements. AARTI IN THE PROCESS OF HANDLING HAZARIOUS CHEMICALS AARTI has developed considerable expertise in the reactions mentioned below & in handling the hazardous chemical involved therein. AARTI also has wealth of experience in unit operations such as DISTILLATION & CRYSTALLISATION. Based on these experiences, AARTI is strategically placed to undertake customized synthesis of organic chemical products. CUSTOM SYNTHESIS IN FOLLOWING REACTIONS PRAGATI SHARMA
  • 219.
    AARTI INDUSTRIES LIMITED • Nitration • Reduction • Condensation • Oxidation • Sulphonation • Methoxylation • Acetylation • Grignard Reaction • Aldol Condensation • Acylation • Alkylation • Michael Addtion • Esterification (Including Asymmetric Esterification) • Meerwin - Pondorf - Verley Reduction • Cyclocondensation • Epoxidation (Chiral & Achiral) • Dehalohydrogenation • Noble Metal Hydrogenation (Catalytic Reduction) • Fischer Indolization • Ammonolysis (Amidation) • Balz - Schiemann (Halex) • Halogenation (Cl, Br, I) • Hydroxylation • Vilsmeier - Haack Formulation • Ullmann Substitutions • Kolbe - Schmidt Carboxylation • Diazotization & Related Chemistry • Oppenauer Oxidation • Friedel Craft • Japp - Klingemann • Sharples Oxidation PRAGATI SHARMA
  • 220.
    AARTI INDUSTRIES LIMITED • Birch Reduction • Cyanation EXPERTISE IN HANDLING HAZARDOUS CHEMICALS • Benzene • Liquid Chlorine • Hydrogen • Liquid Ammonia • Thionyl Chloride • Sulphur Trioxide • Sulphur • Dimethyl Sulphate • Chloro Sulphonic Acid • Potassium Fluoride • Concentrated Nitric Acid • Hydrogen Fluoride PRAGATI SHARMA
  • 221.
  • 222.
    AARTI INDUSTRIES LIMITED MAINTENANCE DEPARTMENT The maintenance of plant is important for the smooth running of any company. AIL following three types of maintenance are done. They are as follows  Electrical maintenance  Civil maintenance  Mechanical maintenance Electrical maintenance The electrical maintenance includes the maintenance of the following factor: a. Motors b. Telephone system c. Electrical installation d. Switch gears e. Meters f. Generators g. Lighting h. Fans PRAGATI SHARMA
  • 223.
    AARTI INDUSTRIES LIMITED Civil maintenance The civil maintenance mainly includes the maintenance of the following. They are as follows: a. Building construction b. Service facilities (water, A/C, ventilation) c. Fire fighting d. House keeping e. Scrap disposal f. Janitor g. Gardening h. Drainage Mechanical maintenance The mechanical maintenance mainly includes the following factors: a. Machine and equipments b. Transport vehicles c. Material handling equipment d. Steam turbine and electricity. Type of maintenances used in AIL: • Reactive maintenances. • Preventive maintenance. Benefits of locations  It is an GIDC area  Convenient in infrastructure. PRAGATI SHARMA
  • 224.
    AARTI INDUSTRIES LIMITED  Easy availability of local employment.  Convenience in transportation through rail and road  Good earnings.  Availability of market  Better communication system  Availability of water and electricity supply PRAGATI SHARMA
  • 225.
    AARTI INDUSTRIES LIMITED EFFLUENT TREATMENT PLANT All the AARTI’s large scale manufacturing units have their own Effluent Treatment Plant (ETP) with facilities for Primary, Secondary and Tertiary treatment of effluent. In Sarigam, Gujarat, under the initiative of AIL, all the small units have formed a new company named "Perfect Enviro Control Systems Pvt. Ltd." and have PRAGATI SHARMA
  • 226.
    AARTI INDUSTRIES LIMITED set up a Common Effluent Treatment Plant, which is the first private ETP facility. This effort has been well appreciated by the World Bank. Our other small manufacturing units are the members of the Common Effluent Treatment Plants in their respective regions. ETP section play very important role in AIL. In this section there is only two person’s working. The HOD of this section is Mr. Maruti Patil. Responsibility The following are main responsibility of ETP section:  They control total area of south Gujarat.  They provide training to employees about function of computer.  All the maintenance and repairs of computers.  They provide software program as well as hardware function to other department of the organization as per requirement.  Proper watch the user about their proper function.  It after training also, employee is not proper working inform to General Manager.  If there is any break down of system, it is their responsibility to provide and make workable as soon as possible.  They provide new developed programmers to required department  Purchase of system is also the responsibility of ETP section. PRAGATI SHARMA
  • 227.
    AARTI INDUSTRIES LIMITED DECANTER OLD NEUTRALIZER CENTRIFUGE STORE PRIMARY WATER PIT EQUALIZATION TANK BIOREACTOR CLARIFIER SLUDGE COLLECTOR ACTIVATED CARBON V-NUTCH REFINEMENT SECONDARY COLUMN CHAMBER TANK CLARIFIER FINAL OUTLET SLUDGE DRYING CHAMBER BED Effluent is any waste material produced during the course of various manufacturing process in any industry or for that matter chemical industry. Waste water can be classified as: PRAGATI SHARMA
  • 228.
    AARTI INDUSTRIES LIMITED  Domestic waste water.  Process waste water.  Cooling waste water. To treat this waste water before letting it anywhere is mandatory and requires a series of stepwise systematic processing called as “Effluent treatment plant”. It is also very important to meet the ever increasing stringent emission norms of Pollution control boards; AIL is controlled by G.P.C.B. (GUJRAT POLLUTION CONTROL BOARD), which is the controlling authority; hence the need for studying ETP. The stepwise working of the ETP here can be explained as follows:- 1) STORE WATER PIT:- The effluent from various plants first comes to a holding tank where oil, Grease and solids are separated. The remaining stream goes to the equalization cum neutralization unit via 3 pumps of 5 HP, 10 HP, and 10 HP and flow rate of 8m/hr. 2) EQUALIZATION TANK:- It’s the heart of ETP, because all the variations occurring in the plant is stabilized here. It’s a simple tank with a capacity provided 15% extra considering PRAGATI SHARMA
  • 229.
    AARTI INDUSTRIES LIMITED emergency situations. Here we have two equalization tanks. Here we can add some neutralizing, coagulating and flocculating agents. The tiles of the equalization tank are made of a resin called as C.N.S.S.L. and are acid proof. The mastic work consist of lining of brick tiles 3) DECANTER CENTRIFUGE:- After neutralizing by caustic, we send it to flash mixer where we add polyelectrolyte (heavy resins) to flocculate the small particles to from bigger particles. Then the stream is sent to primary clarifier. The input stream is sent to primary clarifier. The input stream of slurry to the decanter centrifuge should be maintained below 20%. 4) PRIMARY CLARIFIER:- Basically it is like a sedimentation process where smaller particles are coalesced and then separated. For this an agitator where a proper RPM is maintained is required, so that the particles are coalesced and not broken and our objective is achieved. The heavy particles settle down and removed as sludge drying bed. About 80% treatment is done in primary clarifier. 5) BIO-REACTOR:- The overflow of the primary clarifier goes to the bioreactor where bacteria are fed with food and nutrients like jaggery, diammonium phosphate (DAP), etc. the PRAGATI SHARMA
  • 230.
    AARTI INDUSTRIES LIMITED bacteria averages 0.5 to 1 micrometer in diameter. Some standard conditions are required to be maintained which are as follows:-  PH: It is maintained between 5.5 to 6.5 for minimum impact on the environment. Bicarbonate alkalinity is required to keep this pH at right levels.  Temperature: It normally ranges from 25 to 30 C.  Dissolved oxygen: The bacterium requires some additional oxygen for their survival. The minimum value to be maintained is around 5 mg/L. for this an agitator is used. We use Activated Sludge Process (ASP) with recycle. The outlet of bioreactor goes to secondary clarifier. It works on similar lines as of primary clarifier. 6) ACTIVATED CARBON COLUMN : PRAGATI SHARMA
  • 231.
    AARTI INDUSTRIES LIMITED The overflow of the secondary clarifier goes to activated carbon column via a polishing tank and V-nutch chamber. Here we have a sand column followed by activated carbon column where the remaining effluents are absorbed. The column is regenerative type of column. 7) SLUDGE DRYING BEDS:- The bottom of the primary and secondary clarifier goes to sludge drying beds, which are two in number and are essentially sands beds. The water from this along with the activated carbon bed outlet is to equalization vessel. The sludge is packed in gunny bags and sent to sludge waste management company ltd. (S.W.M.C.L.). PRAGATI SHARMA
  • 232.
  • 233.
    AARTI INDUSTRIES LIMITED SWOT ANALYSIS STRENGTHS  It had strong technical base with the core whole time director being technocrats with sound entrepreneur skills.  The company being a multi location, multi product entity has manufacturing abilities for a large number of products which enables them to change of product mix as per market demands.  In house research and development centers recognized by the department of scientific and industrial research enables continuous research for new products process improvements, energy consumption reduction etc.  The company has a large customer both local and international. The company has strived to serve them with loyalty since inception. It is the support of these customers as well as that of its supplier that has enabled the company to sustain its growth.  The company has always given priority to environment, health and safety. It has technologically upgraded efficient treatment facilities at all its units.  The company is having an additional advantage which includes stocking points in US, Europe, Japan and Logistics Advantage. WEAKNESS PRAGATI SHARMA
  • 234.
    AARTI INDUSTRIES LIMITED  House keeping is not up to the mark.  Centralized decision making which many a times hinders the functioning of different departments. PRAGATI SHARMA
  • 235.
    AARTI INDUSTRIES LIMITED OPPORTUNITIES  The company is stream lining its new units at Vapi and Tarapur for custom synthesis and USFDA approved pharmaceutical manufacturing.  The company is also working out marketing tie-ups with multinational for its existing and new range of product.  The company has a large customer base comprising multinational and global majors. This fact coupled with the in house, competent R&D team gives opportunities to increase volumes in existing products and to introduce new products. THREATS  The company’s threat perception is the shifting of some of its end usage product to china. Accordingly the company is making continuous efforts to increase its presence in china.  The company’s ability to change its product mix quickly, its vast range of products numbering about 75% and its foray into specialty chemical and pharmaceuticals also makes the company confident of countering this threat effectively. PRAGATI SHARMA
  • 236.
  • 237.
  • 238.
  • 239.
    AARTI INDUSTRIES LIMITED INDEX PART 2 (SPECILIZATION) SR. NO TOPIC PAGE NO 1 HUMAN RESOURCE AUDIT 1-13  INTRODUCTION 1-2  CONDUCTING A HUMAN RESOURC AUDIT 3  GOALS OF THE AUDIT 3  FOCUS OF AUDIT 4  WHY DO AN AUDIT 4  PRELIMINARY STEPS 5  WHAT DOES AN HR AUDIT COVER 5-6  DATA COLLECTION METHODS 7  CODES OF CONDUCT 8-13 o CODE OF CONDUCT OF AIL 8-13 2 HR AUDITING OF AARTI INDUSTRIES LIMITED 14-45  INTRODUCTION 14-18  HUMAN RESOURCES PLANNING 19  RECRUITMENT AND SELECTION 20-22  EDUCATION, TRAINING, AND 23-26 DEVELOPMENT o EDUCATION AND TRAINING 23-24 o EMPLOYEE DEVELOPMENT 25-26  LEAVES OR EMPLOYEE ENTITLEMENTS 26 PRAGATI SHARMA
  • 240.
    AARTI INDUSTRIES LIMITED  PERFORMANCE MANAGEMENT 27-28  COMPENSATION 29-32  LABOR RELATIONS & EMPLOYEE 33-34 RELATIONS  DIVERSITY AND EQUAL EMPLOYMENT 35-37 OPPORTUNITY  SAFETY AND ENVIRONMENT 38-41  DOCUMENTATION & INFORMATION 42 SYSTEMS 3 FORMS 43 4 LIMITATIONS 44 SR. NO TOPIC PAGE NO 5 FINDINGS 45-46 6 RECOMMENDATIONS 47 PRAGATI SHARMA
  • 241.
    AARTI INDUSTRIES LIMITED HUMAN RESOURCE AUDIT An Audit is a means by which an organization can measure where it currently stands and determine what it has to accomplish to improve its human resources function. It involves systematically reviewing all aspects of human resources, usually in a checklist, ensuring that government regulations and company policies are being adhered to. The key to an audit is to remember it is a learning or discovery tool, not a test. There will always be room for improvement in every organization Audits help determine the effectiveness of an HR department and/or HR systems. They are a systematic, objective tool to assess regulatory or policy compliance in the workplace. Often in assessing a company’s business practices and legal compliance, the emphasis is on the company’s financial records. It is equally important, however, to assess HR policies and practices, including the less concrete and less tangible areas that deal with employee dignity and well-being. These are harder to measure, but their impact on productivity can be significant. Additionally, poor business practices can lead to very expensive legal sanctions. Just Audits help determine the PRAGATI SHARMA
  • 242.
    AARTI INDUSTRIES LIMITED effectiveness of an HR department and/or HR systems, audits can be valuable tools in assessing HR policies and practices and ensuring that the company maintains a safe and respectful work environment. Human resources and the HR department perform a wide variety of activities. The audit works best when the focus is on analyzing and improving the Human Resource function in the organization. The Human Resources (HR) Audit is a process of examining policies, procedures, documentation, systems, and practices with respect to an organization’s Human Resource functions. The purpose of the audit is to reveal the strengths and weaknesses in the organization’s human resources system, and any issues needing resolution. The audit itself is a diagnostic tool, not a prescriptive instrument. It will helps to identify what you are missing or need to improve, and it may even tell you what you need to do to address these issues. It is most useful when an organization is ready to act on the findings, and to evolve its HR function to a level where it’s full potential to support the organization’s mission and objectives can be realized. HR audits typically are conducted in the workplace itself, with the HR department using a multipoint checklist defining those "must haves" to ensure that a company is legally compliant under both state and national government regulations. The audit specifies conditions that should be met and then determines whether they are or are not. Often, interviews are conducted randomly with employees and managers to determine the culture or climate with regard to acceptable/unacceptable behaviors in the workplace. Once an HR audit is conducted, a company will know exactly what needs to be done to ensure its legal compliance. PRAGATI SHARMA
  • 243.
    AARTI INDUSTRIES LIMITED Depending on the size of the organization, the number of workplace facilities and other complexities, an audit can take anywhere from a half a day to several days to conduct. CONDUCTING A HUMAN RESOURCES AUDIT. As the Employment law is an ever-changing field. The company’s policies and procedures must change with the laws if the company hopes to avoid litigation. Employers are aware that one of the best ways to avoid employee lawsuits is to have a comprehensive policy manual. That’s good advice, but it’s not enough. So all the companies must regularly conduct human resources audit. GOALS OF THE AUDIT. The goals of conducting audit’s are o To determine whether company’s policies are being applied consistently and whether they are consistently communicated to all employees. o Are the mission and strategy of the human resource organization designed to match the business strategy of the organization? o Are the kinds of people who run the human resource function good choices for the ongoing tasks? PRAGATI SHARMA
  • 244.
    AARTI INDUSTRIES LIMITED o It should distinguish between policies that are applicable to nonunion employees, and the terms and conditions of employment for employees who are represented by a labour organization. o Finally, the review process should provide answers to several important questions regarding the application of company’s policies. FOCUS OF AUDIT. The focus while conducting an Audit will be on:  What unit is to be analyzed? In large corporations, the focus of the audit can be the total corporate personnel / human resource management function, or it can be the divisional or subsidiary level. Whatever the focus, the audit's boundaries must be specified from the start. My focus of auditing was human resource department manager. WHY DO AN AUDIT  To insure the effective utilization of an organization’s human resources.  To review compliance with a myriad of administrative regulations.  To instill a sense of confidence in management and the human resources function that it is well managed and prepared to meet potential challenges. PRAGATI SHARMA
  • 245.
    AARTI INDUSTRIES LIMITED  To maintain or enhance the organization’s and the department’s reputation in the community. PRELIMINARY STEPS There are two issues that must be considered before implementing an employment law Audit:- ö When should the audit take place? ö Who should conduct the audit? Since the Municipality already utilizes a variety of employment-related practices and procedures, the audit should be conducted as soon as possible, if you have never audited such procedures before. After the initial audit, follow-up audits should be conducted annually. When putting together an audit team, include either in-house or outside legal counsel, a representative from Human Resources, or any other individuals needed to represent a cross-section of staff functions. All team members should be warned ahead of time regarding the handling of confidential information. WHAT DOES AN HR AUDIT COVER? The HR audit is broken into areas of evaluation that include what is needed before a company hires any employees all the way through the process of recruiting new employees, bringing them aboard, enrolling them in benefits programs, safeguarding their confidential information, managing and supporting them, and participating in their exit from the company, if necessary, either voluntarily or otherwise PRAGATI SHARMA
  • 246.
    AARTI INDUSTRIES LIMITED While conducting the auditing in AARTI INDUSTRIES LIMITED I tried to cover each and every point among them are the HR planning, recruitment & selection, leaves, training and development, benefits, compensation, diversity and equal employment opportunity, performance appraisal, employee relations, safety and environment, documentation and information system and also the forms that are available on the spot while conducting the auditing in the AIL. What does a full HR Audit entail"? Generally the HR audit involves the following things in it:  Legal compliance  Compensation/Salary Administration  Employment/Recruiting  Terminations  Training and Development  Employee Relations PRAGATI SHARMA
  • 247.
    AARTI INDUSTRIES LIMITED  Communications  Files/Record Maintenance/Technology  Policies and procedures (including employee handbook) DATA COLLECTION METHODS The sources of collection of data are the • Primary source • Secondary source The primary sources of data are: The sources from where the data can be collected are as follows  Interviews with Senior Management: Focus on strategy and a definition of the current state of the organization and the desired future state.  Interviews and Questionnaires with Line Management: Focus on their interactions with the HR function, their human resource problems, and the role they envision for the HR organization.  In-Depth Questionnaires from the Human Resource Staff: Diagnose the jobs, activities, conflicts, and internal strengths and weaknesses of the function. PRAGATI SHARMA
  • 248.
    AARTI INDUSTRIES LIMITED  Archival Information and Documents: Describe job histories, past evaluations, formal structures, and general background on the organization as a whole and the HR function in particular. The primary source of data was used to collect the information that consisted of in-depth Questionnaire: to the Human Resource Manager covering almost all points that a human Resource Audit should involve. Secondary source of data are: The secondary source is where the data are readily available. The secondary source was not used / considered. CODES OF CONDUCT Codes of conduct detail issues that are not regulated by law but are the standards, behaviours and expectations set by the employer in the workplace. Policies associated with codes of conduct may cover matters such as: fighting, language, dress standards, alcohol, drugs, smoking, and confidentiality, other employment, maintaining the workplace, taking care of organization property, theft, and statements to media. CODE OF CONDUCT FOR THE BOARD MEMBERS AND SENIOR MANAGEMENT OF AIL INTRODUCTION As required under Clause 49 of the Listing Agreement as amended up to date, AARTI Industries Limited (herein referred to as “the Company”), hereby notifies the PRAGATI SHARMA
  • 249.
    AARTI INDUSTRIES LIMITED “Code of Conduct for the Board Members and Senior Management of AARTI INDUSTRIES LIMITED” (hereinafter referred to as “the Code”). All the Directors and members of the Senior Management are mandatorily required to understand and adhere to the code/standards prescribed herein, including any amendments /modifications/ replacements thereof as may be notified by the Board of Directors of the Company from time to time, in the course of their dealings, exercise of powers and discharge of their duties, responsibilities and obligations in relation to the Company and its transactions. Nothing in this Code of Conduct or related communications creates or implies an employment contract or term of employment. VIOLATIONS OF LAW  Violations of law, this Code of Conduct or other Company policies or procedures should be reported immediately to the Managing Director and/ or the Compliance Officer in writing.  Violations of law, this Code of Conduct or other Company policies or procedure can lead to disciplinary action up to and including termination/vacation of office. APPLICABILITY This code shall be applicable to all the Board Members (referred to as `Directors’) and Senior Management of the Company. PRAGATI SHARMA
  • 250.
    AARTI INDUSTRIES LIMITED PART A – DEFINITIONS 'COMPANY’ Means AARTI INDUSTRIES LIMITED 'BOARD MEMBERS’ Means Board of Directors of AARTI INDUSTRIES LIMITED 'SENIOR MANAGEMENT’ Means, personnel of the company who are members of its core management team excluding Board of Directors (BOD). This would comprise of all members of management one level below the executive directors, including all functional heads. 'COMPLIANCE OFFICER’ Means the office appointed by the BOD for the purpose of this code from time to time. PART B – COMPLIANCE COMPLIANCE OFFICER PRAGATI SHARMA
  • 251.
    AARTI INDUSTRIES LIMITED The Company has appointed Mr. Mohan P. Sonar, Company Secretary as Compliance officer for the purpose of this Code and he shall report to the Managing Director of the Company. AFFIRMATION OF COMPLIANCE All Board members and senior management personnel of the Company shall affirm compliance with this Code on annual basis in such form as may be prescribed and send it to the Compliance Officer by 30th April each year. The Annual report of the company shall contain a declaration to this effect. PART C - CODE OF CONDUCT The Directors and Senior Management personnel of the Company shall adhere to the following: 1. Shall act in accordance with the highest standards of personal and professional integrity, honesty and ethical conduct 2. Shall be independent in their judgment and actions. 3. Shall exercise due care and diligence in performance of their duties. 4. Shall comply with all applicable laws, rules, and regulations. 5. Shall not engage in any business, relationship or activity, which may be in conflict of interest of the Company without prior approval of the Board. 6. Shall intimate the Company’s Board of Directors before accepting outside directorships. PRAGATI SHARMA
  • 252.
    AARTI INDUSTRIES LIMITED 7. Shall maintain the confidentiality of the information about of the Company received/obtained by them in the course of their position as Director /employee of the Company, except when disclosure is authorized by the Chairman and/or Vice Chairman and Managing Director of the Company or legally mandated and shall not use confidential information for their own advantage or profit. 8. Shall use best endeavors to protect Company’s assets and property and ensure its efficient use. 9. Shall not derive any personal benefit (including without Limitation through the use of Company’s property, assets, information, or position) except that which they are lawfully entitled to 10. Shall refer all inquiries or calls from the press and financial analysts to the Company’s Managing Director. The Company has designated its Chairman, Vice Chairman and Managing Director, Vice Chairman, as official Company spokespeople for any company related matters. 11. Shall abide by AARTI’S internal code for prevention of Insider Trading. 12. Shall not, directly or indirectly, short sell any equity/security, of the Company so as to make gain out of such sale or otherwise. A short sale means any transaction whereby one may benefit from a decline in the Company’s share/ security price. PRAGATI SHARMA
  • 253.
    AARTI INDUSTRIES LIMITED 13. Shall not derive any benefit (directly or indirectly) or assist others to derive any benefit by giving advice from the access to and possession of price sensitive information about the Company, which are not in public domain. 14. Shall not exploit for their personal benefit, opportunities that are discovered through Company’s business, information or position, unless the same is disclosed fully to the Managing Director and permitted by him. 15. Shall not compete directly or indirectly with the business of the Company or with any business that the Company is considering to establish. 16. Shall treat women employees equally and eliminate any gender discrimination and shall avoid harassment/threatening based on race, color, religion, age, gender, national origin, disability or any other basis. 17. Shall not misuse the Company’s facilities, except where such facilities have been provided for personal use either by policy or by permission or authority or in the normal course of business. The Company’s facilities shall not be used for personal use and even when used with prior approval, care shall be exercised / taken to ensure that costs are reasonable. 18. Shall not (directly or indirectly) accept or retain any gift, entertainment or other benefits from any organization or person doing business or competing with the Company. However, they may accept and offer nominal gifts/hospitality which are not of material value and are customarily given on accessions or are of commemorative nature for special events. PRAGATI SHARMA
  • 254.
    AARTI INDUSTRIES LIMITED 19. Shall affirm compliance with this Code to the Company on an annual basis. (THIS CODE IS SUBJECT TO REVISION. SUCH REVISION SHALL BE WITH THE APPROVAL OF THE BOARD) THE HR AUDITING OF AARTI INDUSTRIES LIMITED Information of the company & person, where auditing was conducted. COMPANY NAME– The company in which the auditing is to be conducted is to be properly known that what are the name in which the company has registered itself and the name in which the company is trading. REGISTERED AS: M/S AARTI INDUSTRIES LIMITED TRADING AS: M/S AARTI INDUSTRIES LIMITED COMPANY’S URL– PRAGATI SHARMA
  • 255.
    AARTI INDUSTRIES LIMITED The URL of the company helps to gain information about the company. The information can be about the products, their company, and if anything new is happening. The URL of AIL is www.aartigroup.com NAME OF THE PERSON – Name of the person was Mr. Kirit G Sashtri. DESIGNATION– The designation of the person was HR Manager. CONTACT– Contact of Mr. Kirit Sashtri is CELL NO: 9377804595 ADDRESS OF THE COMPANY– The address of AIL is as follows. REGISTERED OFFICE CORPORATE OFFICE Plot No. 801,802/23, Udyog Kshetra, GIDC Estate, phase III, 2nd floor, L.B.S. Marg, VAPI_ 396195, Mulund-Goregaon link road, DIST. Valsad, Gujarat. Mulund (W), Mumbai 400 080. TYPE OF COMPANY– PRAGATI SHARMA
  • 256.
    AARTI INDUSTRIES LIMITED The company is a Chemical Company. TOTAL NO OF EMPLOYEES – • The total numbers of employees working in the AIL is 503. • Among them 180 are in staff. • There are no casual employees. • 323 employees are doing the job of operators and • There are 250 contract workers. DEPARTMENT MISSION – Firstly the overall objective or purpose of the human resources department within the Organization and its relationship to the Organization's overall mission is to be known. The mission of the human resource department of AIL is as follow: • Taking care of employee welfare, • Emphasize on appropriate training to all the employees and be open to all their suggestions through team participation. • Maintaining health care system in the company. The further questions asked were: PRAGATI SHARMA
  • 257.
    AARTI INDUSTRIES LIMITED  The overall objective or purpose of the human resources department within the organization to the organization's overall mission is linked or not? YES (  ) NO ( ) ANS: The department’s mission and that the organization’s mission is linked to each other or not is also important to glimpse. And it was found that the organization purpose was matching with the human resource department objective.  Does the company have formal HR manual? YES ( ) NO (  ) ANS: AIL does not have any HR Manual or any manual for their employee.  Are all he key policies covered in the manual? YES ( ) NO (  ) ANS: As there is no employee manual the policies also does not exist at AIL.  Working hours of the employees? PRAGATI SHARMA
  • 258.
    AARTI INDUSTRIES LIMITED ANS: The working hour of employees is 8 hrs. There are 3 shifts in 24 hours.  Overtime hours? ANS: The over time is usually not there but if there is some urgent order which is to be prepared for that the company asks the employees/ workers to do overtime for which they are paid separately.  What is the official retirement age? ANS: The retirement age decided and specified by the AIL to its employees is 58 years.  Does the company offer education assistance to the employees children? YES (  ) NO ( ) ANS: The children of the employees are given education assistance by the AIL. Education assistance is on the merit of the students. The student who scores good marks is given education assistance.  Does any employee work from home? PRAGATI SHARMA
  • 259.
    AARTI INDUSTRIES LIMITED YES ( ) NO (  ) ANS: There is no policy as such in AIL according to which any employee can work from home.  Is the turnover rate high than expectation? YES ( ) NO (  ) ANS: The turnover ratio of AIL is not too high if truth be told not many people leave the company and go. HUMAN RESOURCES PLANNING – The Human Resource Planning means the prior planning of the human resource. How the company pre plans for the people to recruit and select in the organization is to be known.  Do you know your employment needs beyond the current year? YES (  ) NO ( ) ANS: According to the employee turnover. Also that now the company is expanding itself, the company needs human resource.  Have you engaged in a strategic planning process to clarify your employment needs? PRAGATI SHARMA
  • 260.
    AARTI INDUSTRIES LIMITED YES (  ) NO ( ) ANS: The department heads if they need more employees under it, gives a written letter demanding employees under them and the reason why they require more employees. RECRUITMENT AND SELECTION – Recruitment and selection is obtaining and evaluating qualified candidates from internal and external sources for positions throughout the Organization. The Human Resource Manager of AIL was asked these questions on the recruitment and selection topic.  Is the selection process transparent, equitable, based on merit, and appropriate? YES (  ) NO ( ) ANS: The AIL has a recruitment process in which every candidate is equal and there is no biasness which can take place. The recruitment is done with complete honesty and the process is completely based on the merit PRAGATI SHARMA
  • 261.
    AARTI INDUSTRIES LIMITED and the performance of the candidate in the interview, recruitment and the selection process.  Are new employees provided with a comprehensive induction? YES (  ) NO ( ) ANS: The new employee in the AIL is given a formal introduction and then made familiar with the people whom he is going to work with. This is to make him aware of the company, people and the environment in which he is going to work with.  Before filling a position do you identify the skills, qualifications and behaviours of candidate, needed to meet your objectives? YES (  ) NO ( ) ANS: The AIL while conducting the recruitment and the selection process notice the attitude and the behaviour of the candidates. Through the response or the answers of the question asked to the candidates the AIL (people conducting the recruitment process) come to know whether the candidate is competent for the job or not.  Do job descriptions exist? YES (  ) NO ( ) PRAGATI SHARMA
  • 262.
    AARTI INDUSTRIES LIMITED ANS: While recruiting the candidate to his post the company gives a complete description about 1. What is his job? 2. What he is going to do? 3. What duties and responsibilities that he is going to perform? Etc...  Are job descriptions up to date? YES ( ) NO (  ) ANS: In AIL the job description exists in the AIL but it is not reviewed or updated by the company.  Are applicant references checked? YES ( ) NO (  ) ANS: The AIL checks the reference of their newly if they find it necessary. Normally employee reference is not checked.  Are turnover rates monitored? PRAGATI SHARMA
  • 263.
    AARTI INDUSTRIES LIMITED YES ( ) NO (  ) ANS: The AIL does not monitors the employee turnover rate.  Is the selection procedure clearly told to the candidates? YES (  ) NO ( ) ANS: The Company informs the candidates previously itself about the procedure of the selection so that there is no confusion in the mind of the candidates regarding the procedure. EDUCATION, TRAINING, AND DEVELOPMENT – Providing performance skills training and career development to employees, utilizing both internal and external resources, includes providing expertise in assessing education, training, and development needs and identification of high- potential employees. The AIL was asked these questions on the education, training and the development of their employees. EDUCATION, TRAINING, AND DEVELOPMENT  Do you provide performance or skills improvement training? YES (  ) NO ( ) PRAGATI SHARMA
  • 264.
    AARTI INDUSTRIES LIMITED ANS: If any employee is not that competent and needs training then that employee is given training to improve his skills, performance and work quality.  Do you utilize both internal and external resources for training? YES (  ) NO ( ) ANS: The AIL uses both internal as well as external sources for the training. The internal training is where the trainer from the company itself. And in the external training the company asks the institutes to give training to their employees.  Does the training include expertise in assessing education, and development needs? YES (  ) NO ( ) ANS: Suppose if there is any safety training then a safety expert is being called and asked to give the training so that if there is any technical problem which is not understood by the employee then it is being solved by the experts.  Are seminars held in the company? YES (  ) NO ( ) ANS: The Company some times conducts seminars for their employees and for their benefits. PRAGATI SHARMA
  • 265.
    AARTI INDUSTRIES LIMITED  Do you offer employee in house training by the companies employees only? YES (  ) NO ( ) ANS: The Company also gives the employees training from the senior employees working in the company.  Do you offer external training source? YES (  ) NO ( ) ANS: The AIL does offer external training more than the internal training as the experts are being called for giving training to their employees. EMPLOYEE DEVELOPMENT  Do you have a way to identify the employees development needs of your employees? ( e.g. surveys, reviews, performance management) YES (  ) NO ( ) ANS: The AIL identifies the employees development needs as the AIL gives training to their employees and if any of the employees work or performance is not good they come to know that the employee is not developing. The company goes for the performance management as away to know the development need of an employee which is conducted at the year ending. PRAGATI SHARMA
  • 266.
    AARTI INDUSTRIES LIMITED  Do employees in your work area get the development they need to do their jobs effectively? YES (  ) NO ( ) ANS: The development is through the training that are given at regular period to all the employees and motivated for good work.  Do you monitor the results of employees’ development activities in order to assess their effectiveness? YES (  ) NO ( ) ANS: The AIL once in the end of the year sees that which are the employees who are to be given a promotion and development. The employee who performs well is been promoted.  Are new employees offered mentoring support? YES (  ) NO ( ) ANS: The AIL does give mentors support to its new employee so that the mentor helps the employee in understanding the work and help the employee if he faces any problem while working. PRAGATI SHARMA
  • 267.
    AARTI INDUSTRIES LIMITED LEAVES OR EMPLOYEE ENTITLEMENTS The leaves given to the employees also do matter that how many days in a year they have leaves and how many days they get leaves with no harm in their pay.  Total annual leaves: given by the AIL to its employees is 7 days.  Total sick leaves: is 9 days leave annually.  Privilege leave: Are 26 days annually. PERFORMANCE MANAGEMENT  Are employees clear about what is expected of them in their work roles? YES (  ) NO ( ) ANS: When the employees are recruited in the company at the very same time they are told and informed about what are their duties, responsibilities, the working environments prevailing and the expectations of the organization at which they have to stand.  Are employees clear about what is expected of them in their work roles? YES (  ) NO ( ) PRAGATI SHARMA
  • 268.
    AARTI INDUSTRIES LIMITED ANS: When the employees are recruited in the company at the very same time they are told and informed about what are their duties, responsibilities, the working environments prevailing and the expectations of the organization at which they have to stand.  Is quality and quantity of work evaluated? YES (  ) NO ( ) ANS: The work fulfillment, whether the employee is completing his work on time and effectively is observed. There is no formal method of evaluation.  Is there a system for performance evaluation? YES (  ) NO ( ) ANS: For performance evaluation there is no such specific method. Performance appraisal of employee is done once at the year ending and that the subordinates rates their superior and the superior rates their subordinated and both of their rating s are reviewed by the superior of their both.  Is performance tied to compensation? YES (  ) NO ( ) ANS: If the performance of the employee is up to the mark then the AIL gives the employee an increment and also sometimes awards are given for good performance to motivate the employees. PRAGATI SHARMA
  • 269.
    AARTI INDUSTRIES LIMITED  Is there any poor work performance policy in the company? YES ( ) NO (  ) ANS: There is no such policy in the AIL for the poor work performance of the employee in the company.  Is there any performance appraisal policy and procedure? YES ( ) NO (  ) ANS: There is no performance appraisal policy in the company but the company does have a procedure of the performance appraisal. The performance appraisal takes place once at the end of the year. COMPENSATION – All cash payments to employees and also the systems by which positions are evaluated, salary and wage ranges and bands are determined, and adjustments are made, including commissions, lump sum payments, incentive payments, and bonuses.  Is there a formal pay structure? YES (  ) NO ( ) ANS: The Board of Directors are to be provided with the Salary of Rs.85,000/- per month with power to make an annual increment area under PRAGATI SHARMA
  • 270.
    AARTI INDUSTRIES LIMITED discussion to a maximum amount of Rs.1,50,000/-per month in respect of salary and privilege up to 100% of salary. For the employees the pay structure is decided when they are recruited that what will be their pay. Salary is usually paid in the first week of every month. Salary officer prepare covers with the name and personal code No., of employees and the pay slip along with cash or cheque as per grade.  Are compensation levels monitored and reviewed? YES ( ) NO (  ) ANS: In AIL the compensation structure is not reviewed regularly. The compensation structure is reviewed once in a year.  Is working time documented? YES (  ) NO ( ) ANS: When an employee whether he is manager or an employee or a contract employee they have to fill up the register, where the timing of their entrance and exit is noticed.  Are paid time off (vacation, holidays, etc) structures developed? YES (  ) NO ( ) ANS: The Paid Holiday, Sick Leave, Casual Leave, Privilege Leave all these leaves and holidays are calculated by the company and records of these leaves/holidays of each and every employee is recorded and maintained. PRAGATI SHARMA
  • 271.
    AARTI INDUSTRIES LIMITED  Is the compensation plan communicated to all employees? YES ( ) NO (  ) ANS: The Company does not communicate the compensation plan to its employees.  Is contact made with medical providers? YES (  ) NO ( ) ANS: Whenever and wherever necessary the company contacts the hospitals or medical providers if any emergency.  Are injuries/incidents investigated? YES (  ) NO ( ) ANS: If any accident is occurred in the AIL and the employee is injured then there is a complete investigation done of the incident held and then according to the injuries caused to the employee the employee is given compensation.  Is follow-up remediation performed where appropriate? YES (  ) NO ( ) ANS: Whether the incident is small or big the employee who is injured is rushed for the First Aid to ensure employees safety. There is an emergency Van in the company which is kept for any emergency purpose also the First Aid is kept in the company. PRAGATI SHARMA
  • 272.
    AARTI INDUSTRIES LIMITED Are insurance premiums reviewed on a periodic basis? YES (  ) NO ( ) ANS: The AIL gives insurance to each and every employee except to those employees who come under ESIC. Those employees are insured by the government. As the employees under ESIC gets all kind of benefits.  Is the workplace environment maintained with safety in mind? YES (  ) NO ( ) ANS: The Company has kept in mind the safety of the employees. So there is 71 points to avoid fire hazard and emergency exit also.  Are compensatory administrative costs included in the budget? YES ( ) NO (  ) ANS: There is no compensatory cost included in the budget by the company as there is no compensatory policy decided by the company. LABOR RELATIONS & EMPLOYEE RELATIONS – The role of the human resources role in the relationship between the Organization and any bargaining unit of an employee-organized labor group, including labor-organizing campaigns. The formal policies and procedures governing all conditions of employment, including specific human resources activities not otherwise categorized.  Is there a positive climate in your work area where employees are motivated in their work? PRAGATI SHARMA
  • 273.
    AARTI INDUSTRIES LIMITED YES (  ) NO ( ) ANS: In AIL each and every employee in every department is of friendly nature. Some likes and dislikes exist but still everyone work together and enjoy their work and creates positive environment around them.  Does the company have union? YES ( ) NO (  ) ANS: The AARTI INDUSTRIES do not have any union.  Is there any grievances solving procedure? YES (  ) NO ( ) ANS: The AIL has a unique way for solving the grievance. If any of the employees has any grievances then they can straight away meet the Managing Director of the company and tell him the problems and the Managing Director will try to solve the problem.  Are the communication channels between management and employees in your work area sufficiently consultative so that disputes are avoided and effective problem solving is fostered? YES (  ) NO ( ) ANS: Whether the dispute is small or big the employee can go to the Managing Director with their disputes and he will help in solving the disputes. PRAGATI SHARMA
  • 274.
    AARTI INDUSTRIES LIMITED  Are you comfortable working with the companies disciplinary measures and grievance procedures? YES (  ) NO ( ) ANS: When asked this question to the Human Resource manger he said that the employees in the company including him all are satisfied with this type of Grievance solving procedure as the Managing Director is very cooperative.  Are workplace policies flexible? YES ( ) NO (  ) ANS: There is no as work place policy exist in AIL. Except the objectives, rules and regulations of the company which have to be maintained with proper discipline by each and every employee of the company. Are disciplinary actions for violating workplace policies flexible? YES ( ) NO (  ) ANS: There is no such kind of policy so no disciplinary actions are taken.  Is there a process for employees to lodge complaints? YES (  ) NO ( ) ANS: The employee can either complain to their department head or can meet the Managing Directors for their problems and complaints. PRAGATI SHARMA
  • 275.
    AARTI INDUSTRIES LIMITED  Are there a variety of individuals to whom employees may lodge complaints (supervisor, HR representative)? YES ( ) NO (  ) ANS: There is no such procedure where the employee may lodge complaints to their superior, supervisor, or HR manager. The Managing Director is contacted directly by the employees. DIVERSITY AND EQUAL EMPLOYMENT OPPORTUNITY Developing and implementing workforce programs to maximize employment of productive people with different characteristics, qualifications, and talents while recognizing the legal requirements and social responsibilities of equal treatment for all employees and the actions necessary to ensure those requirements are met.  Do all your employees receive fair and equitable treatment? YES (  ) NO ( ) ANS: Yes each and every employee in the company is fairly treated whether the employee is the worker or the manager.  Are supervisors and managers trained in anti-discriminatory practices? YES (  ) NO ( ) PRAGATI SHARMA
  • 276.
    AARTI INDUSTRIES LIMITED ANS: The employees are given seminars and lectures where they are made understood that what should be their behaviour towards the other employees in the company and that do not discriminate among worker or a manager. Every one in the company should be equally treated.  Are employment practices in line with the various anti-discrimination laws? YES (  ) NO ( ) ANS: There is no discrimination done in AIL among anyone. And there a notice kept that the anti-discriminative laws are not violated by any of the employees. EMPLOYEE BENEFITS Some organizations provide a range of employee benefits not prescribed by legislation or awards. These can relate to such matters as employee health, or assisting employees to balance work and family responsibilities. It is important to clarify how such benefits are awarded to employees in an organization policy in order to ensure that all employees know of their availability, they are distributed fairly, and that any conditions applying are understood. PRAGATI SHARMA
  • 277.
    AARTI INDUSTRIES LIMITED Employee benefits, which fall into this category, may include: company cars, mobile phones, employee assistance programs, salary packaging, career breaks, and working from home and study assistance. The noncash compensation provided to employees of the Organization including, but not limited to, such components as insurances, retirement saving plans, and paid time off, and the systems, support services, and communications to successfully deliver the benefits.  Does the company provide the employees with Insurance benefits? YES (  ) NO ( ) ANS: Yes. AIL being a chemical company provides each and every employees with the insurance benefits. The employees coming under ESIC are not given insurance benefits.  Does the company provide the employees retirement saving plans? YES (  ) NO ( ) ANS: The aged employees who are working in AIL since years and are to be retired in few years are given retirement saving plan.  Does the company provide the employees with the loan facilities? PRAGATI SHARMA
  • 278.
    AARTI INDUSTRIES LIMITED YES (  ) NO ( ) ANS: The Company gives loans to its employees. There is no limit of loan provided to the employees. If the employee need loan to build own house, car etc. also for the employee’s parents the loan is given to build house, education loans for the employee’s children are also given. SAFETY AND ENVIRONMENT – Audit practices will vary considerably among companies when considering factors that contribute to a safe work environment. A company may choose to develop an audit sheet tailored to a particular issue, such as the company’s zero- tolerance policy for harassment. In truly safe work environments, employees feel confident that they have a place to go when they have work-related problems. They model the behavior and communicate relevant procedures and resources so that everyone feels comfort-able and safe. An open-door policy is well worth the effort of writing and then providing training to managers and supervisors regarding how to deal with employees who may come to them with concerns The training, communication, and leadership required to provide a safe working environment; to provide an appropriate level of employee involvement and responsibility for implementing safe practices, using safety equipment, and complying with Organization safety rules and practices; and to ensure that federal, state, and local safety and environmental requirements are met.  Is there any non-smoking policy? YES (  ) NO ( ) PRAGATI SHARMA
  • 279.
    AARTI INDUSTRIES LIMITED ANS: There is a non smoking policy for all the employees and no employees should smoke in the premises of the organization and anyone found violating those rules will be punished and severe actions will be taken on them.  Do employees participate in regular safety and health training programs? YES (  ) NO ( ) ANS: All the employees are previously informed about the date and time at which training is to be held. Every employee has to participate in the training it is held every week. The schedule is listed every month.  Are workplace accidents, near-misses, injuries, and illnesses reported and investigated? YES (  ) NO ( ) ANS: Yes if there are any mishaps then they are to be straight away reported to the senior management and they investigate the accident properly and the employee is rushed to the hospital without delay.  Are measures in place to prevent thieves from entering the grounds or buildings? YES (  ) NO ( ) PRAGATI SHARMA
  • 280.
    AARTI INDUSTRIES LIMITED ANS: There is a tight security in the premises of the AIL. The security in charge takes care that there is no theft or robbery that takes place in the company and there are 6-7 security in charge (people) remain at night in the company premises.  Is bright, effective lighting installed indoors and outdoors? YES (  ) NO ( ) ANS: The AIL has set up good lighting facility in the premises. There is lighting at each place and there is no dark place this is to avoid working accidents of employee working at the night time.  Are measures in place (access badges, traffic control, etc.) to keep unauthorized persons from entering the facility through normal entrances? YES (  ) NO ( ) ANS: Through the normal entrance only authorized people are allowed to enter. The truck drivers have to show the identity card given by the company at the entrance. The visitors are asked the person to meet and then conformation is done from that employee and then the visitor is allowed in the company.  Is there a reliable response system in place in the event an alarm is triggered? PRAGATI SHARMA
  • 281.
    AARTI INDUSTRIES LIMITED YES (  ) NO ( ) ANS: In the situation of an emergency an alarms is rung and then all the employees are asked to vacate that particular area and reach at a safer place. If there is a fire then the nearest fire point is switched on.  Are employees encouraged to promptly report incidents, and suggest ways to reduce or eliminate risks? YES (  ) NO ( ) ANS: The employees are previously educated that they should be careful while working with the chemicals and that they should wear proper safety equipment like gumboots, helmet and gloves (if necessary). All this things can avoid accidents in the company.  Do you maintain OSHA? YES (  ) NO ( ) ANS: The Company does maintain OSHA. This is for the safety of the organization as well as of the employees.  From how many years? PRAGATI SHARMA
  • 282.
    AARTI INDUSTRIES LIMITED ANS: OSHA is maintained in AIL since its commencement of the company. DOCUMENTATION AND INFORMATION SYSTEMS – Preparing, storing, and maintaining employee records and information, including computerized human resources information systems, and meeting federal, state, and local requirements  When operational changes are introduced into your work area do you take into consideration the impact on employees? YES (  ) NO ( ) ANS: As AIL is very much concerned about its employees the company while making any policy or decisions keep in mind their employees safety and employee welfare.  Are documents regarding employees kept for their required duration? YES (  ) NO ( ) PRAGATI SHARMA
  • 283.
    AARTI INDUSTRIES LIMITED ANS: The AIL keeps and maintains each and every legal documents with them regarding their employees and the company itself. As whenever it may be needed they can show them (auditor’s visits). FORMS  Factory act half yearly returns.  Annual return  Renual of LIC  Notice of accident  Report on accident  Minimum wage act annual returns  Payment of wage act annual  ESIC reports  Bonus act annual returns  Provident fund monthly returns All these are the list of forms which the AIL always keep with them and they are properly maintained. As these forms are required any time and asked by the auditors of the company. PRAGATI SHARMA
  • 284.
    AARTI INDUSTRIES LIMITED LIMITATIONS The limitations are as follows:  I did not have complete knowledge about the different policies of the government that are set for the betterment of the employees which the companies should follow.  There was some biasness in response of the HR manager towards his company.  The company could not disclose much of the confidential matters of their policies and procedures. PRAGATI SHARMA
  • 285.
    AARTI INDUSTRIES LIMITED FINDINGS The findings are as follows.  The objective and purpose of the department and the organization should match and in case of AIL also it matches.  As per the company’s act the companies should have an HR manual which the AIL does not have.  The employee turnover ratio in the company is high. Which the company should take in notice and keep a proper record of it.  The company has good recruitment and selection procedures for the selection of the candidates.  The training given as per schedule to the employees.  As per the company’s act the company should have a job description of each and every employees which is not proper in the AIL.  Employee development is only by training and not by transfers.  The performance management system is not properly managed. The employees are appraised once in a year. PRAGATI SHARMA
  • 286.
    AARTI INDUSTRIES LIMITED  The company is committed to ensure sound safety, health and environment (SHE) performance related to its activities, products and services. The company is taking continuous steps and also developing environment friendly processes for the effective resource management with specific focus to energy, water and basic raw materials.  The company is committed to strengthen, pollution prevention and waste abatement practices and strives to provide a safe and healthy environment.  The employee safety is the biggest importance for AIL which is given most preference and they do very satisfactorily. AIL has ensured safety and health of its employees.  The relationship between the management and the employees are good as the directors record their appreciation of the support and co-operation of all employees and count them for the growth of the company.  The documents and forms are available in AIL and they are properly maintained by the company. PRAGATI SHARMA
  • 287.
    AARTI INDUSTRIES LIMITED RECOMMENDATIONS  The AIL does not have any HR employee manual. So AIL should maintain manuals covering all policies  Job descriptions exists in AIL but they are not reviewed regularly. AIL should concentrate on reviewing those policies as for a new positions job descriptions should be readily available at the time of induction training given to the new employees.  Though the turnover rates of employee are not high the company should monitor and keep a proper record of the turnover of employees.  AIL should set up an appropriate performance appraisal policy and procedure once in 3-4 months to ensure that all employees understand their job responsibilities and objectives.  The compensation levels should be monitored and reviewed regularly by the AIL. AS PER THE COMPENSATION ACT 1956 the company should review their compensation levels regularly  AIL does not have any policy for the employee violating the regulations and policies of the company. So the company should develop some disciplinary policy to avoid violation of rules & regulations. PRAGATI SHARMA
  • 288.
    AARTI INDUSTRIES LIMITED  There should be a grievance solving procedure in which the employees can lodge complain or grievance to their superior or HR Manager.  The AIL should provide the employees with transportation facilities. For the employees convenience. PRAGATI SHARMA
  • 289.
    AARTI INDUSTRIES LIMITED BIBLIOGRAPHY • KOTLER KELLER, MARKETING MANAGEMENT PRENTICE HALL, NEW DELHI, 12TH EDITION 2006 • ANNUAL REPORT OF THE COMPANY 2005-2006 • HUMAN RESOURCE MANAGEMENT K ASHWATHAPPA - 4TH EDITION • WEB SITES o http://www.hraudit.inc o http://www.amanet.org/books o http://www.e-hresources.com o http://www.hr.uwa.edu.au PRAGATI SHARMA
  • 290.
    AARTI INDUSTRIES LIMITED o http://www.explorehr.org o http://www.jjkeller.com/resourcecenters/hr/home.htm o www.aartigroup.com PRAGATI SHARMA
  • 291.
    AARTI INDUSTRIES LIMITED AARTI INDUSTRIES LIMITED (HUMAN RESOURCE AUDIT) PRAGATI SHARMA
  • 292.
    AARTI INDUSTRIES LIMITED COMPANYNAME- REGISERED AS: _________________________________________ TRADING AS: ___________________________________________ COMPANIES URL- _____________________________________________________ NAME OF THE PERSON- _______________________________________________ DESIGNATION-_______________________________________________________ CONTACT- CELL NO: __________________________________________________ EMAIL ID: ________________________________________________ ADDRESS OF THE COMPANY- _________________________________________ ___________________________________________ TYPE OF COMPANY- __________________________________________________ TOTAL NO OF EMPLOYEES- ___________________________________________ STAFF (_______________) OPERATOR (___________) CASUAL (______________) CONTRACTOR (_________) DEPARTMENT MISSION – ______________________________________________________________________ ______________________________________________________________________  The overall objective or purpose of the human resources department within the organization to the organization's overall mission is linked or not? PRAGATI SHARMA
  • 293.
    AARTI INDUSTRIES LIMITED YES ( ) NO ( )  Does the company have formal HR manual? YES ( ) NO ( )  Are all he key policies covered in the manual? YES ( ) NO ( )  Working hours of the employees? ____________________  Overtime hours? ____________________  What is the official retirement age? ________________  Does the company offer education assistance to the employees children? YES ( ) NO ( )  Does any employee work from home? YES ( ) NO ( )  Is the turnover rate high than expectation? YES ( ) NO ( ) PLANNING-  Do you know your employment needs beyond the current year? YES ( ) NO ( )  Have you engaged in a strategic planning process to clarify your staffing needs? YES ( ) NO ( ) STAFF DEVELOPMENT  Do you have a way to identify the employees development needs of your employees? ( e.g. surveys, reviews, performance management) PRAGATI SHARMA
  • 294.
    AARTI INDUSTRIES LIMITED YES ( ) NO ( )  Do employees in your work area get the development they need to do their jobs effectively? YES ( ) NO ( )  Do you monitor the results of employees’ development activities in order to assess their effectiveness? YES ( ) NO ( )  Are new employees offered mentoring support? YES ( ) NO ( ) RECRUITMENT AND SELECTION-  Is the selection process transparent, equitable, based on merit, and appropriate? YES ( ) NO ( )  Before filling a position do you identify the skills, qualifications and behaviours needed to meet your objectives? YES ( ) NO ( )  Are new employees provided with a comprehensive induction? YES ( ) NO ( )  Do job descriptions exist? YES ( ) NO ( )  Are job descriptions up to date? YES ( ) NO ( ) PRAGATI SHARMA
  • 295.
    AARTI INDUSTRIES LIMITED  Are applicant references checked? YES ( ) NO ( )  Are turnover rates monitored? YES ( ) NO ( )  Is the selection procedure clearly told to the candidates? YES ( ) NO ( ) LEAVES -  Total annual leaves _________________________  Total sick leaves ____________________________  Privilege leave __________________________________ EDUCATION, TRAINING, AND DEVELOPMENT –  Do you provide performance or skills improvement training? YES ( ) NO ( )  Do you utilize both internal and external resources for training? YES ( ) NO ( )  Does the training include expertise in assessing education, and development needs? YES ( ) NO ( )  Are seminars held in the company? YES ( ) NO ( ) PRAGATI SHARMA
  • 296.
    AARTI INDUSTRIES LIMITED  Do you offer employee in house training by the companies employees only? YES ( ) NO ( )  Do you offer external training source? YES ( ) NO ( ) Benefits –  Does the company provide the employees with Insurance benefits? YES ( ) NO ( )  Does the company provide the employees retirement saving plans? YES ( ) NO ( )  Dos the company provides the employees with the loan facilities? YES ( ) NO ( ) Compensation –  Are compensation levels monitored and reviewed? YES ( ) NO ( )  Is there a formal pay structure? YES ( ) NO ( )  Is the compensation structured reviewed regularly? YES ( ) NO ( )  Is working time documented? YES ( ) NO ( ) PRAGATI SHARMA
  • 297.
    AARTI INDUSTRIES LIMITED  Are paid time off (vacation, holidays, etc) structures developed? YES ( ) NO ( )  Is the compensation plan communicated to all employees? YES ( ) NO ( )  Are appropriate payroll withholdings performed? YES ( ) NO ( )  Are injuries/incidents investigated? YES ( ) NO ( )  Is follow-up remediation performed where appropriate? YES ( ) NO ( )  Is contact made with medical providers? YES ( ) NO ( )  Are insurance premiums and competitive quotes reviewed on a periodic basis? YES ( ) NO ( )  Is the workplace environment maintained with safety in mind? YES ( ) NO ( )  Is bonus given annually? YES ( ) NO ( )  Are compensatory administrative costs included in the budget? YES ( ) NO ( ) DIVERSITY AND EQUAL EMPLOYMENT OPPORTUNITY –  Do all your employees receive fair and equitable treatment? PRAGATI SHARMA
  • 298.
    AARTI INDUSTRIES LIMITED YES ( ) NO ( )  Are supervisors and managers trained in anti-discriminatory practices? YES ( ) NO ( )  Are employment practices in line with the various anti-discrimination laws? YES ( ) NO ( ) PERFORMANCE MANAGEMENT  Are probationary employees appraised regularly? YES ( ) NO ( )  Are employees clear about what is expected of them in their work roles? YES ( ) NO ( )  Do employees have access to support and assistance for improvement if their performance is less than expected? YES ( ) NO ( )  Is there a system for performance evaluation? YES ( ) NO ( )  Does the system check for effectiveness of the evaluation? YES ( ) NO ( )  Is quality and quantity of work evaluated? YES ( ) NO ( )  Is performance tied to compensation? YES ( ) NO ( )  Is there any poor work performance policy in the company? YES ( ) NO ( ) PRAGATI SHARMA
  • 299.
    AARTI INDUSTRIES LIMITED  Is there any performance appraisal policy and procedure? YES ( ) NO ( ) EMPLOYEE RELATIONS  Is there a positive climate in your work area where employees are motivated in their work? YES ( ) NO ( )  Does the company have union? YES ( ) NO ( )  Is there any grievances solving procedure? YES ( ) NO ( )  Are the communication channels between management and employees in your work area sufficiently consultative so that disputes are avoided and effective problem solving is fostered? YES ( ) NO ( )  Are you comfortable working with the companies disciplinary measures and grievance procedures? YES ( ) NO ( )  Are workplace policies flexible? YES ( ) NO ( )  Are disciplinary actions for violating workplace policies flexible? YES ( ) NO ( )  Is there a process for employees to lodge complaints? YES ( ) NO ( ) PRAGATI SHARMA
  • 300.
    AARTI INDUSTRIES LIMITED  Are there a variety of individuals to whom employees may lodge complaints (supervisor, HR representative)? YES ( ) NO ( ) SAFETY AND ENVIRONMENT –  Is there any non-smoking policy? YES ( ) NO ( )  Do employees participate in regular safety and health training programs? YES ( ) NO ( )  Are workplace accidents, near-misses, injuries, and illnesses reported and investigated? YES ( ) NO ( )  Are measures in place to prevent thieves from entering the grounds or buildings? YES ( ) NO ( )  Is bright, effective lighting installed indoors and outdoors? YES ( ) NO ( )  Are measures in place (access badges, traffic control, etc.) to keep unauthorized persons from entering the facility through normal entrances? YES ( ) NO ( )  Is there a reliable response system in place in the event an alarm is triggered? YES ( ) NO ( ) PRAGATI SHARMA
  • 301.
    AARTI INDUSTRIES LIMITED  Are employees encouraged to promptly report incidents, and suggest ways to reduce or eliminate risks? YES ( ) NO ( )  Do you maintain OSHA? YES ( ) NO ( )  From how many years? YES ( ) NO ( ) DOCUMENTATION AND INFORMATION SYSTEMS -  When operational changes are introduced into your work area do you take into consideration the impact on employees? YES ( ) NO ( )  Are documents regarding employees kept for their required duration? YES ( ) NO ( ) LIST OF DOCUMENTS AND FORMS YOU KEEP WITH YOU ALWAYS FOR HE REVIEWING AND TO SHOW THE AUDITORS PRAGATI SHARMA
