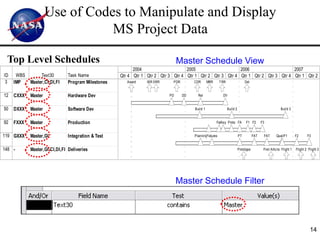

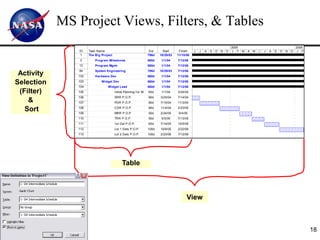

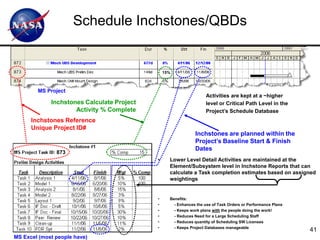

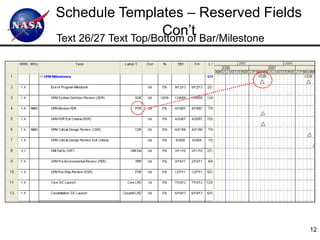

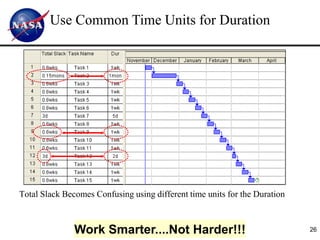

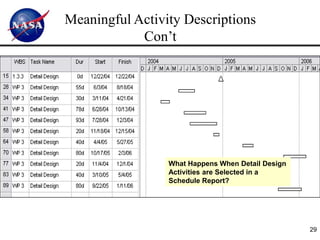

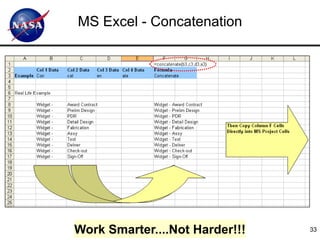

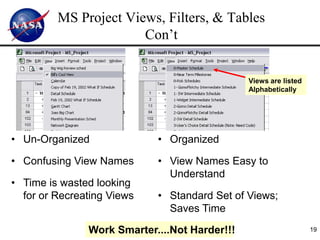

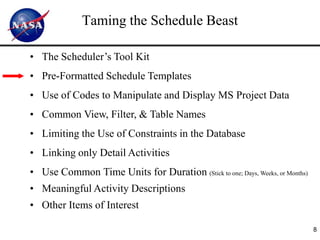

Here are some common views, filters, and tables that can be used in MS Project to organize and display schedule information:
Views - Master Schedule, Intermediate Schedules, Detail Schedules
Filters - By WBS, Milestones, Program Phases, Responsibility, etc.

Tables - Task Name, Duration, Start Date, Finish Date, Predecessors, Successors, Percent Complete
This allows the scheduler to selectively display different levels of the WBS hierarchy and pertinent schedule information depending on the audience or purpose.
