OPEN ACCESS REGULATION
&
GRANT OF CONNECTIVITY REGULATION
Power that any one can access . . .
PRESENTATORS:
 Leela Krishna Vegi
 Sushovan Bej
 Sachin Verma
 Sonu kumar
 Manish Kumar Gupta
 Kartikey Tripathi
OPEN

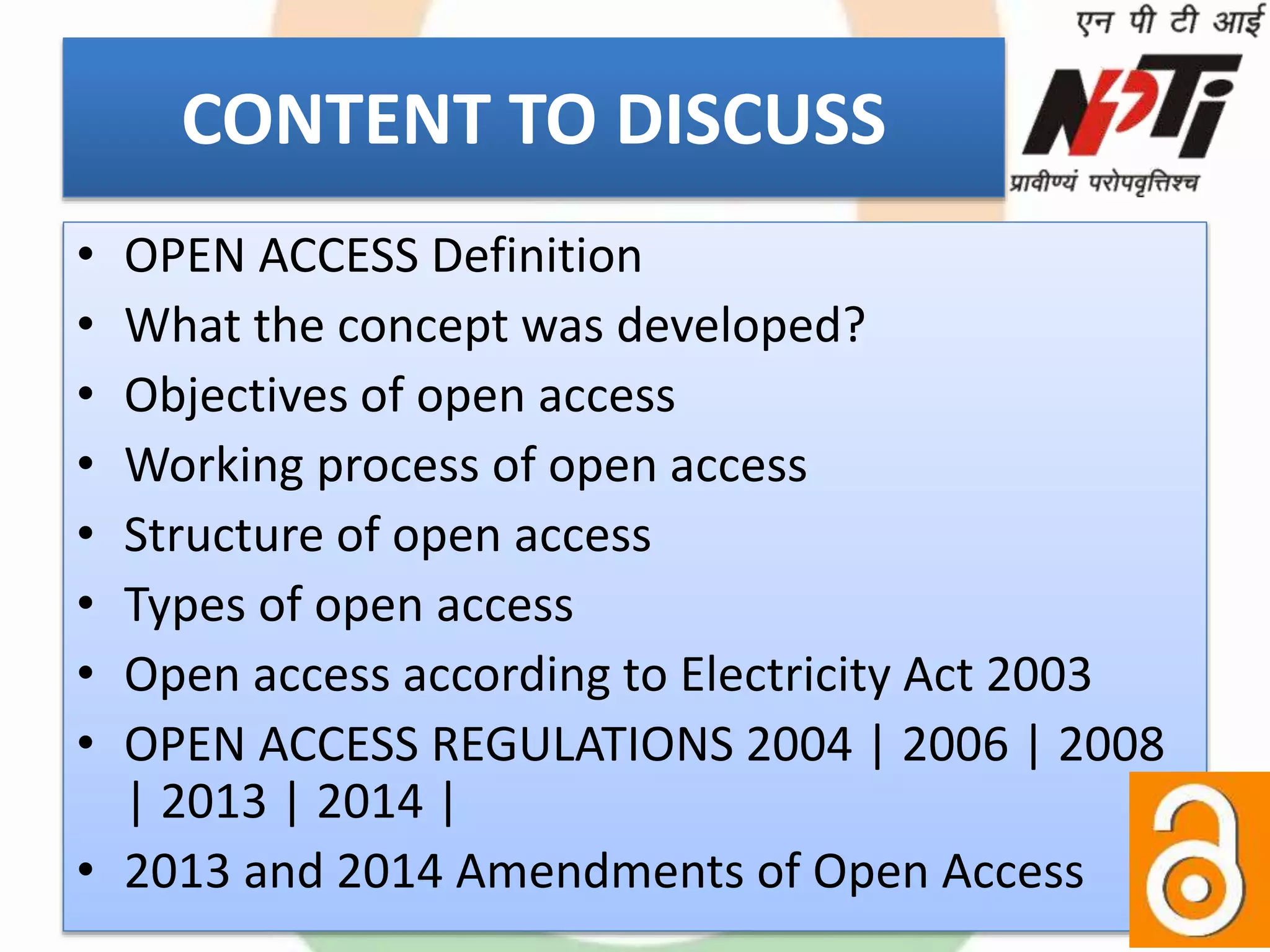

CONTENT TO DISCUSS
• OPEN ACCESS Definition
• What the concept was developed?
• Objectives of open access
• Working process of open access
• Structure of open access
• Types of open access
• Open access according to Electricity Act 2003
• OPEN ACCESS REGULATIONS 2004 | 2006 | 2008
| 2013 | 2014 |
• 2013 and 2014 Amendments of Open Access

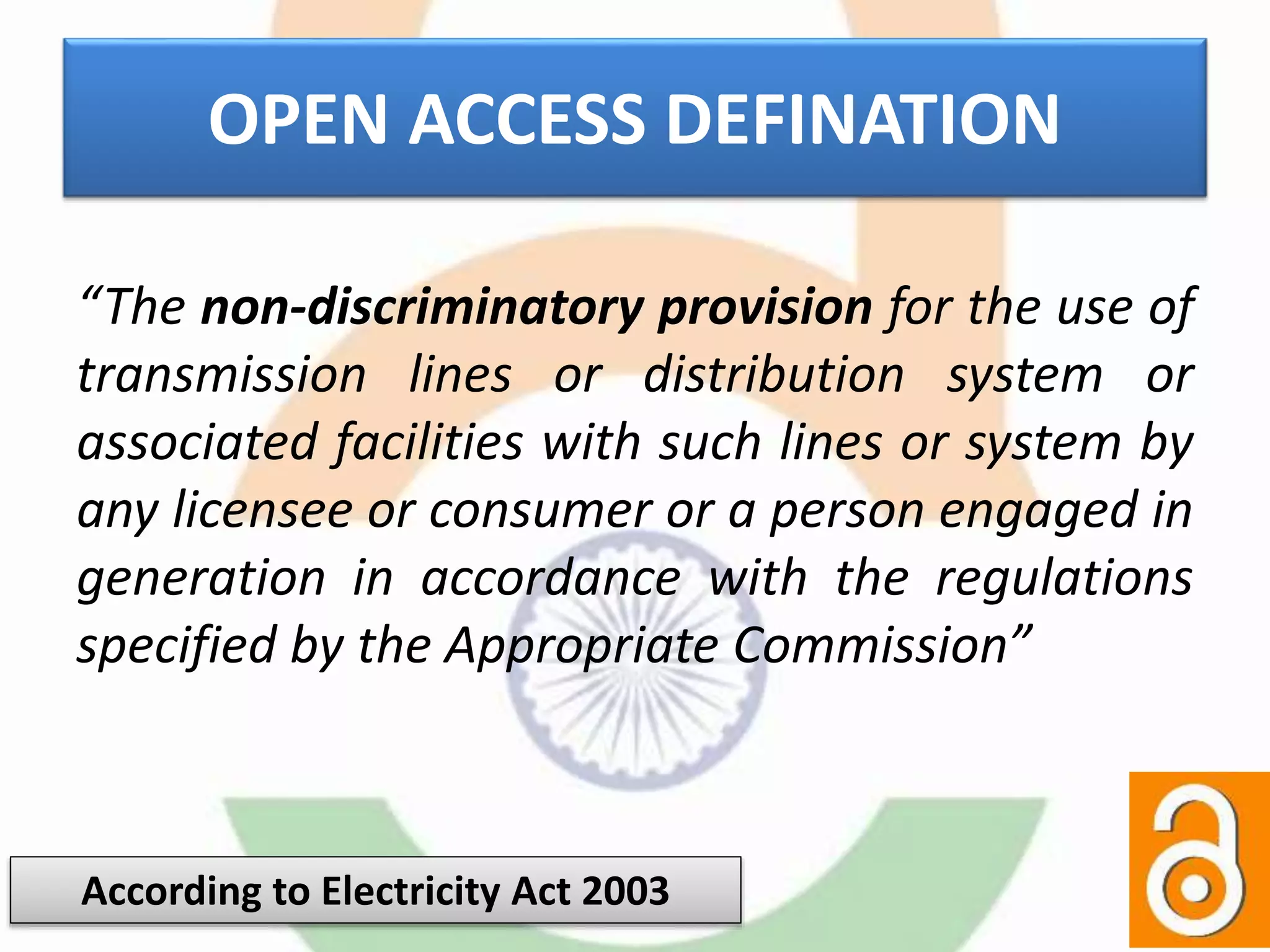

OPEN ACCESS DEFINATION
“The non-discriminatory provision for the use of
transmission lines or distribution system or
associated facilities with such lines or system by
any licensee or consumer or a person engaged in
generation in accordance with the regulations
specified by the Appropriate Commission”
According to Electricity Act 2003

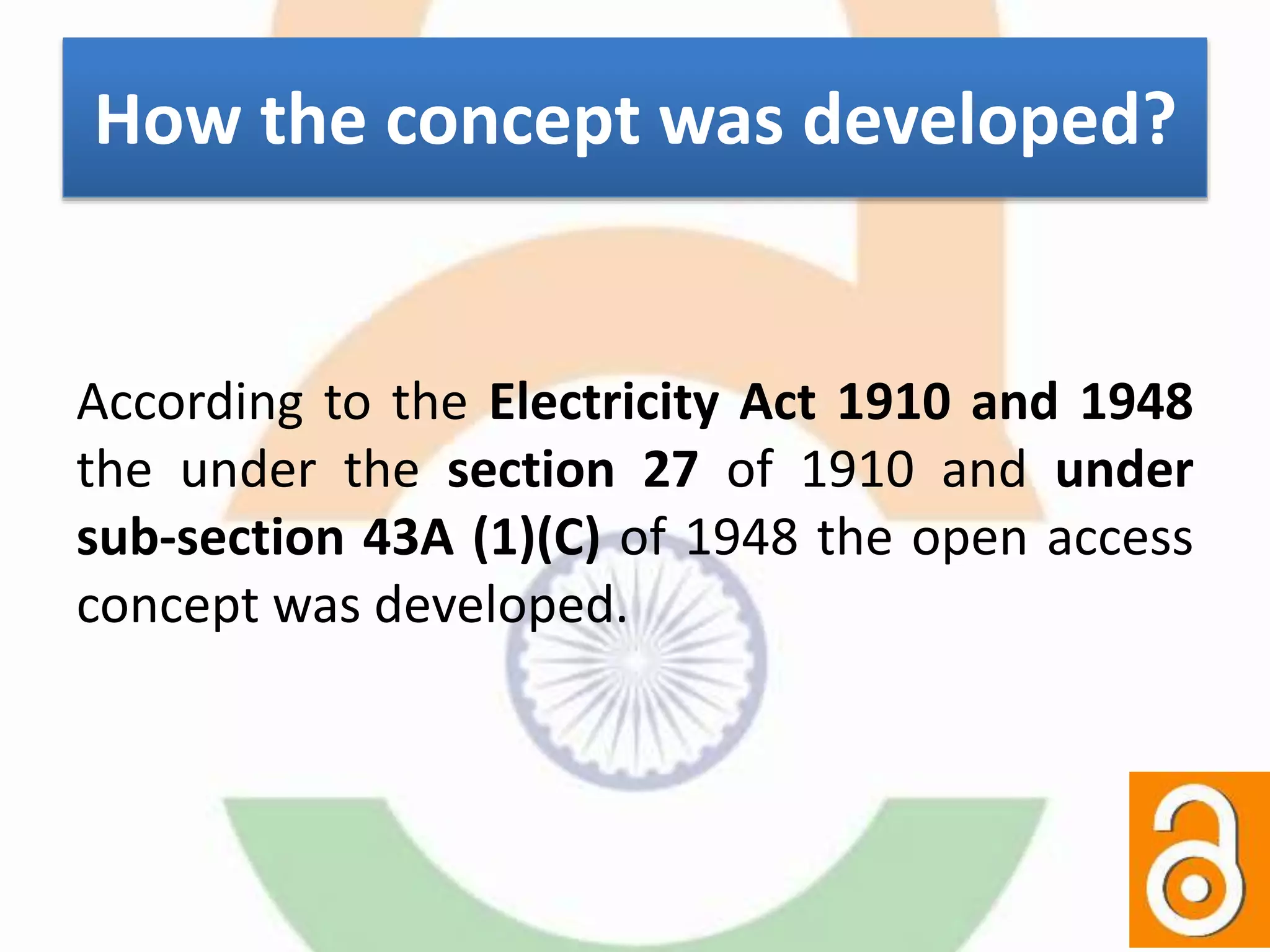

How the concept was developed?
According to the Electricity Act 1910 and 1948
the under the section 27 of 1910 and under
sub-section 43A (1)(C) of 1948 the open access
concept was developed.

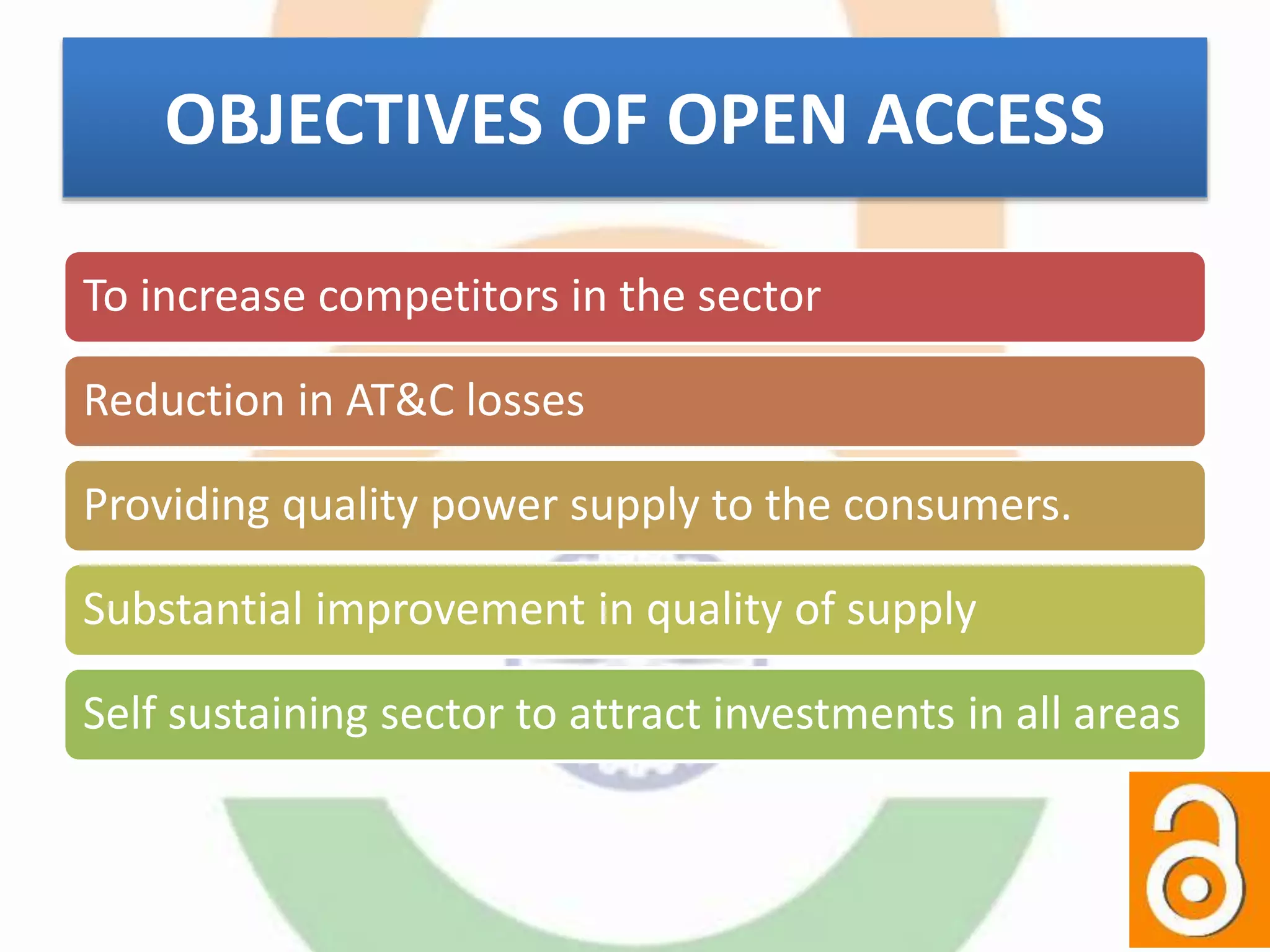

OBJECTIVES OF OPEN ACCESS
To increase competitors in the sector
Reduction in AT&C losses
Providing quality power supply to the consumers.
Substantial improvement in quality of supply
Self sustaining sector to attract investments in all areas

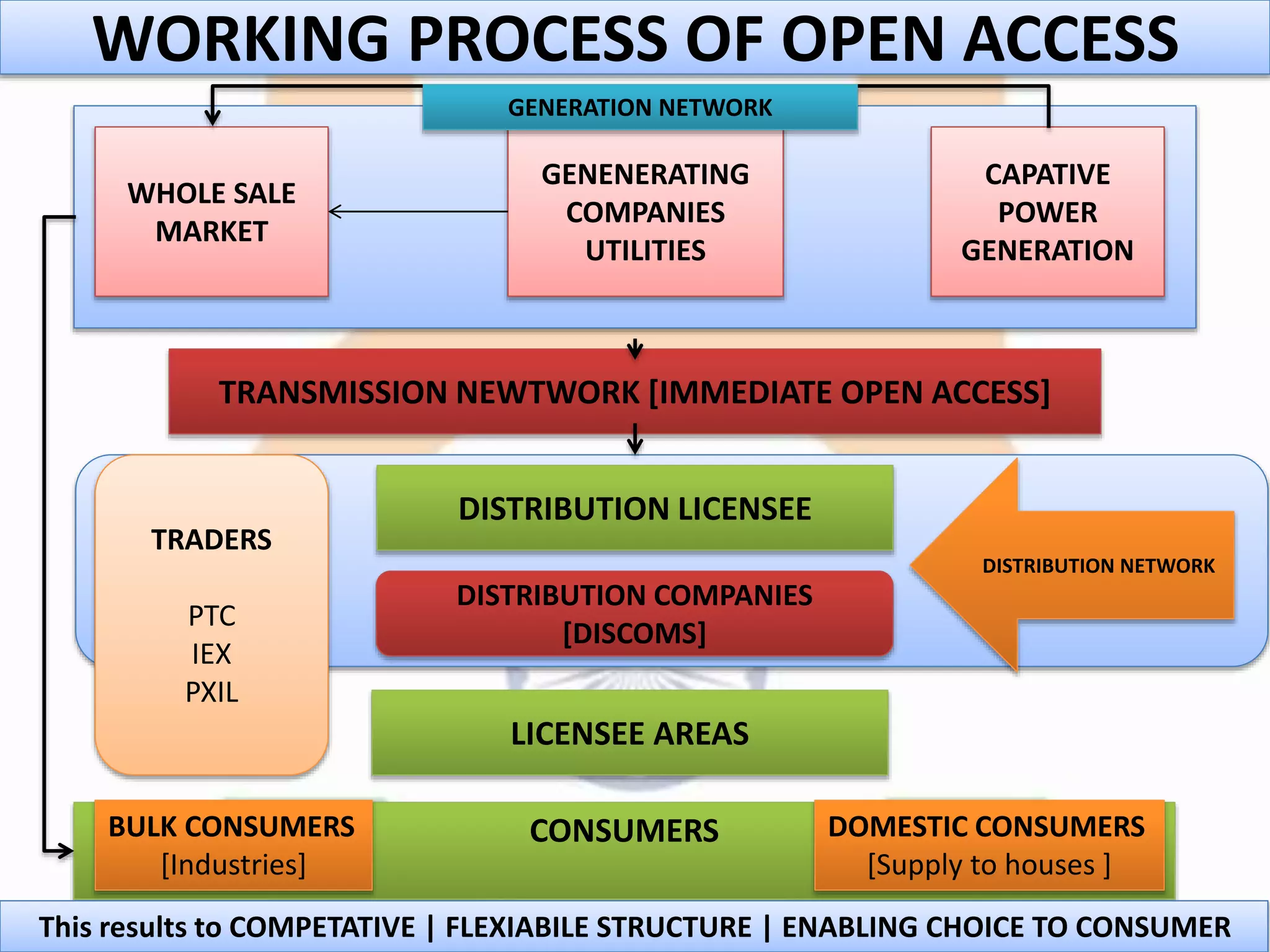

WORKING PROCESS OF OPEN ACCESS
WHOLE SALE
MARKET
GENENERATING
COMPANIES
UTILITIES
CAPATIVE
POWER
GENERATION
TRANSMISSION NEWTWORK [IMMEDIATE OPEN ACCESS]
DISTRIBUTION LICENSEE
DISTRIBUTION COMPANIES
[DISCOMS]
LICENSEE AREAS
CONSUMERS
DISTRIBUTION NETWORK
BULK CONSUMERS
[Industries]
DOMESTIC CONSUMERS
[Supply to houses ]
This results to COMPETATIVE | FLEXIABILE STRUCTURE | ENABLING CHOICE TO CONSUMER
GENERATION NETWORK
TRADERS
PTC
IEX
PXIL
OPEN ACCESS
INTER STATE
OPEN ACCESS
INTRA STATE
OPEN ACCESS
SHORT TERM OPEN ACCESS
MEDIUM TERM OPEN ACCESS
LONG TERM OPEN ACCESS
0 - 3 MONTHS
3 MONTHS - 3
YEARS
12 – 25 YEARS

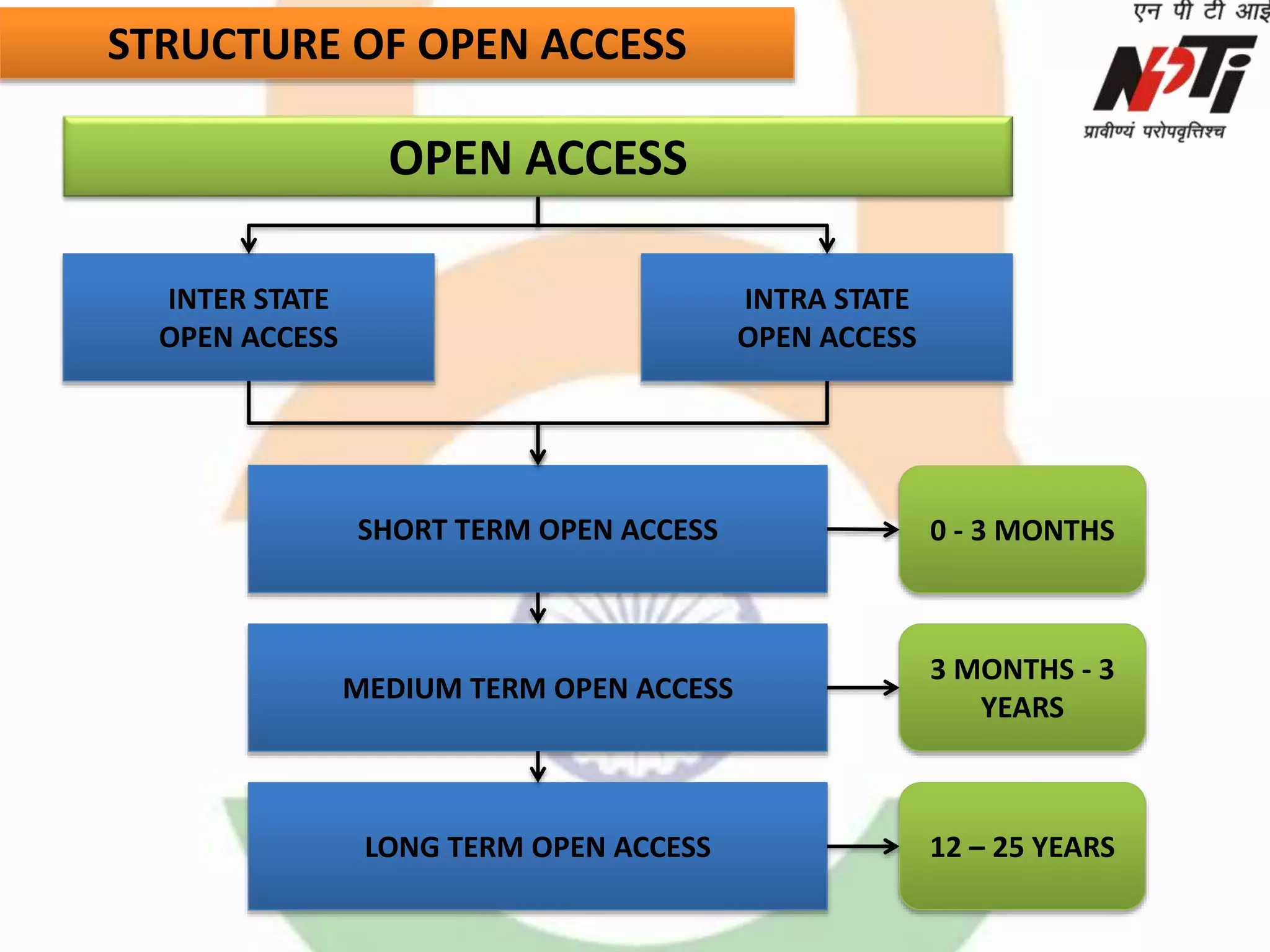

STRUCTURE OF OPEN ACCESS

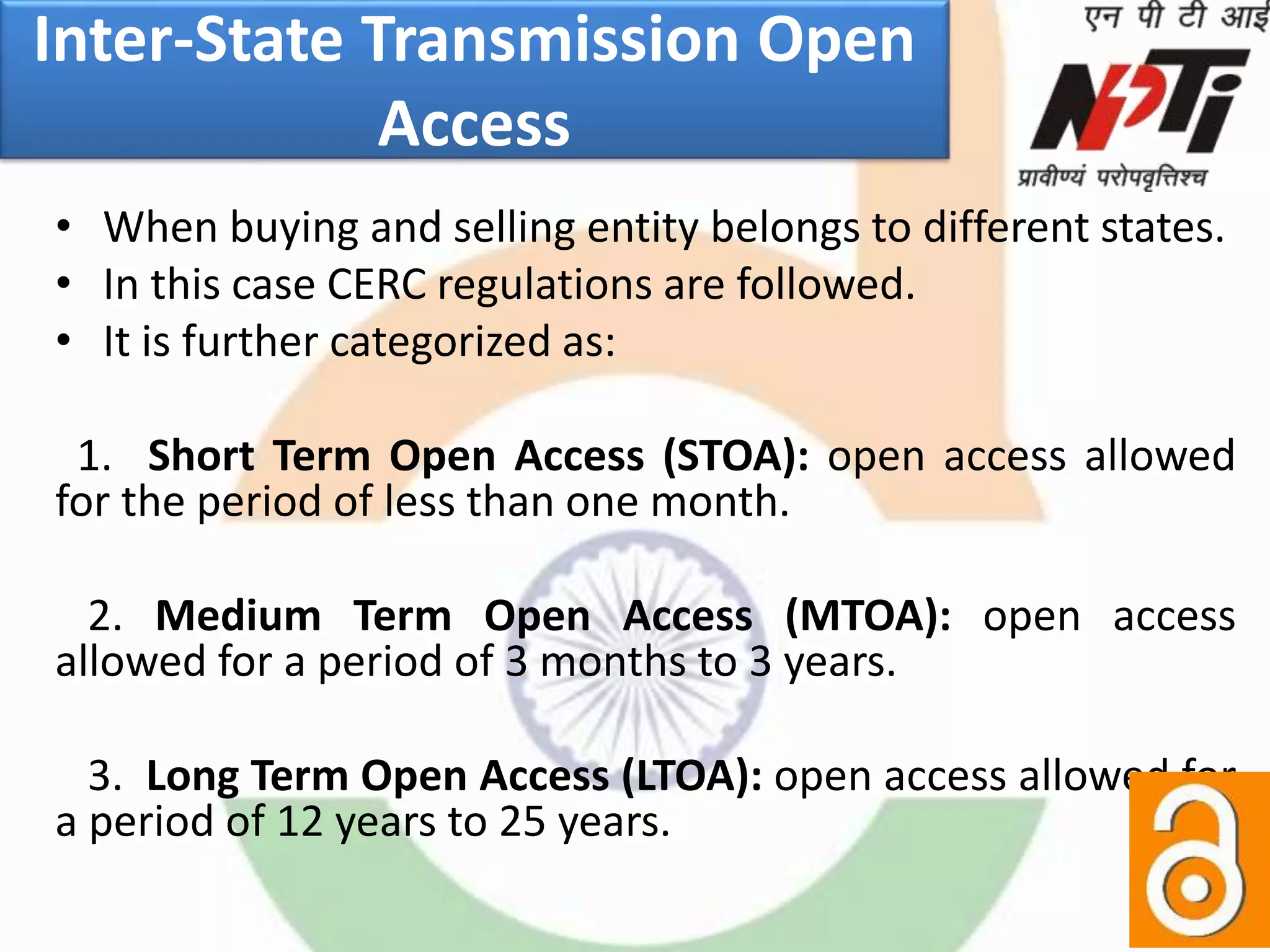

Inter-State Transmission Open
Access
• When buying and selling entity belongs to different states.
• In this case CERC regulations are followed.
• It is further categorized as:
1. Short Term Open Access (STOA): open access allowed
for the period of less than one month.
2. Medium Term Open Access (MTOA): open access
allowed for a period of 3 months to 3 years.
3. Long Term Open Access (LTOA): open access allowed for
a period of 12 years to 25 years.

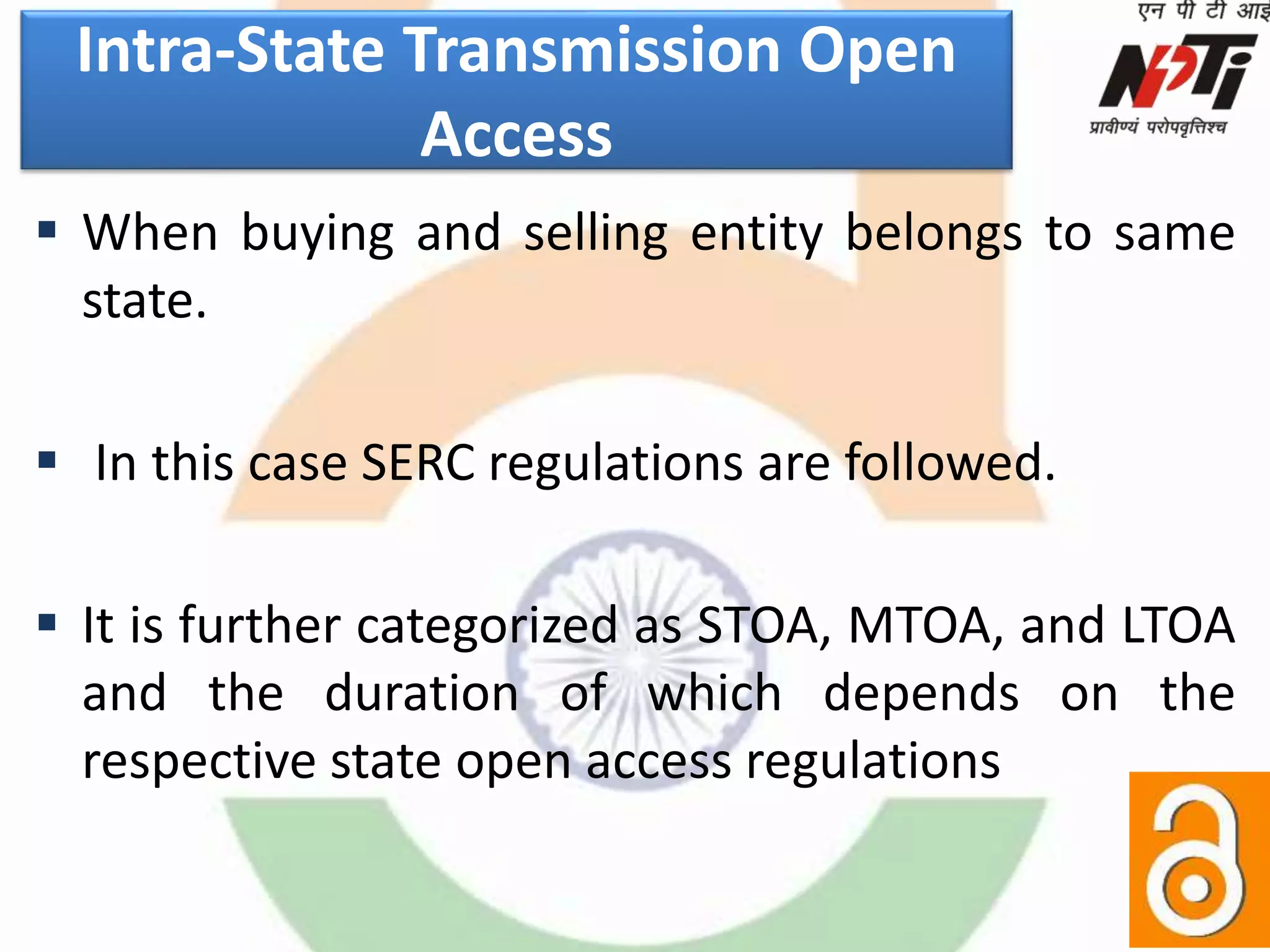

Intra-State Transmission Open
Access
 When buying and selling entity belongs to same
state.
 In this case SERC regulations are followed.
 It is further categorized as STOA, MTOA, and LTOA
and the duration of which depends on the
respective state open access regulations

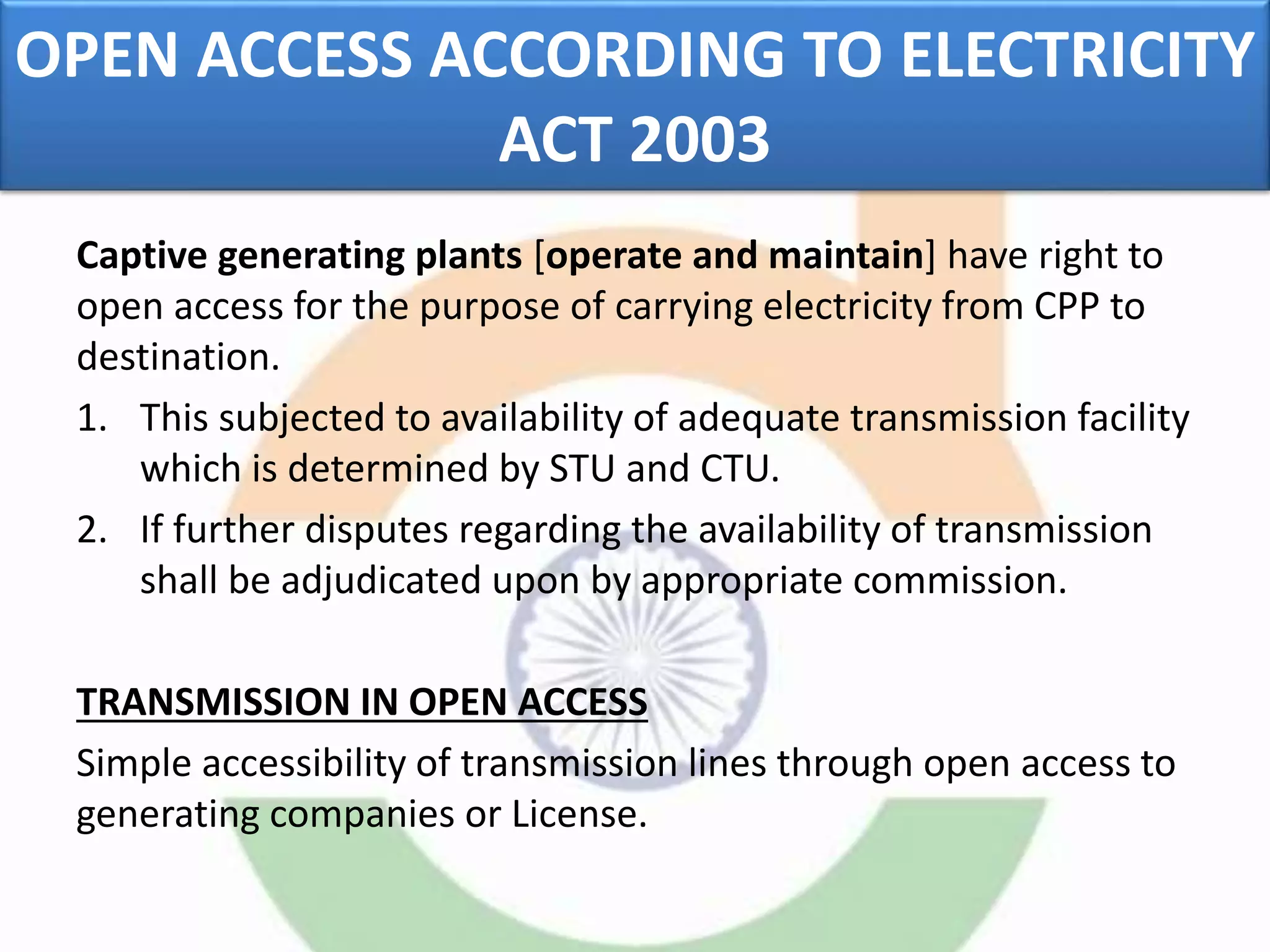

OPEN ACCESS ACCORDING TO ELECTRICITY
ACT 2003
Captive generating plants [operate and maintain] have right to
open access for the purpose of carrying electricity from CPP to
destination.
1. This subjected to availability of adequate transmission facility
which is determined by STU and CTU.
2. If further disputes regarding the availability of transmission
shall be adjudicated upon by appropriate commission.
TRANSMISSION IN OPEN ACCESS
Simple accessibility of transmission lines through open access to
generating companies or License.

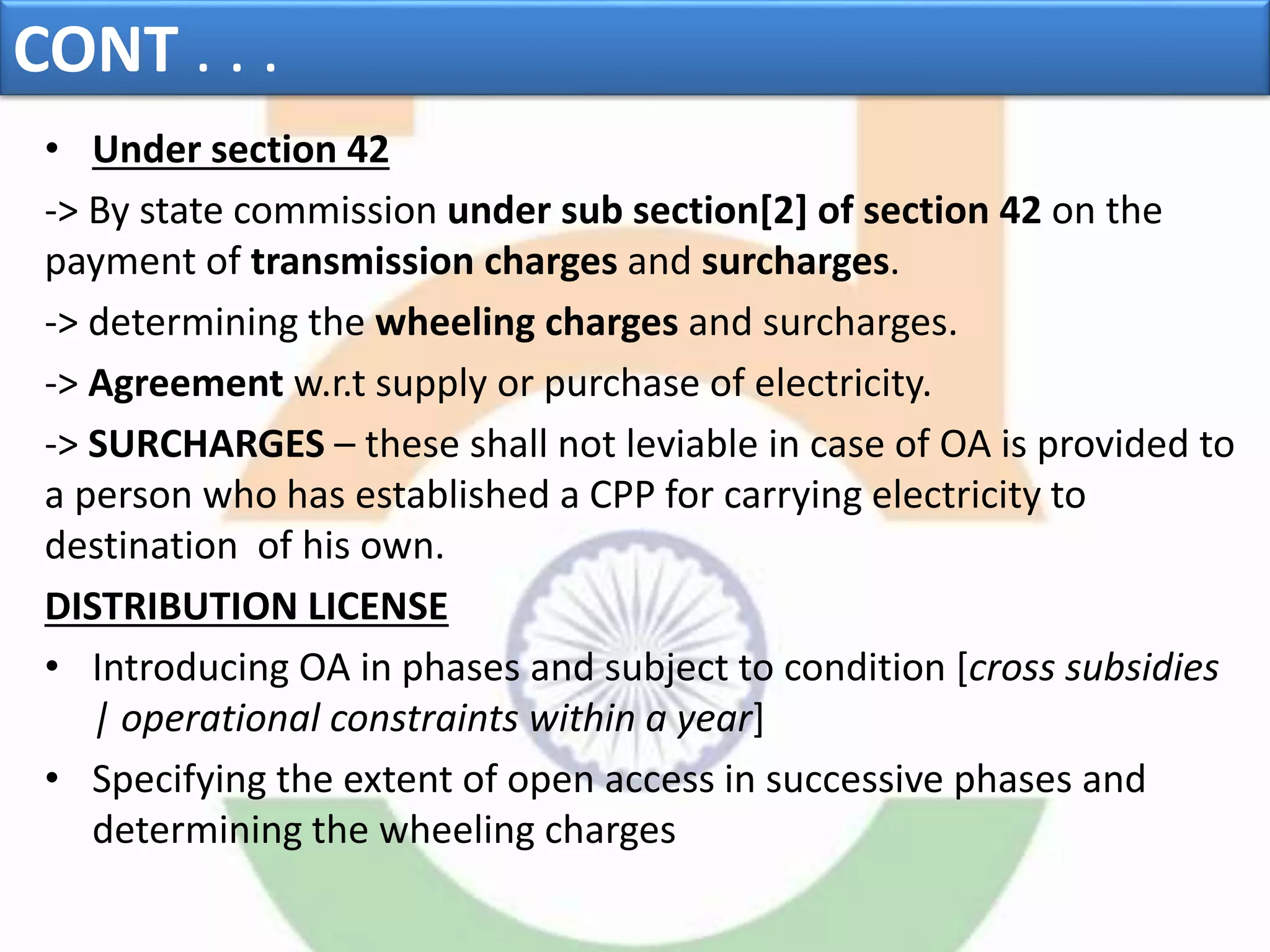

CONT . . .
• Under section 42
-> By state commission under sub section[2] of section 42 on the
payment of transmission charges and surcharges.
-> determining the wheeling charges and surcharges.
-> Agreement w.r.t supply or purchase of electricity.
-> SURCHARGES – these shall not leviable in case of OA is provided to
a person who has established a CPP for carrying electricity to
destination of his own.
DISTRIBUTION LICENSE
• Introducing OA in phases and subject to condition [cross subsidies
| operational constraints within a year]
• Specifying the extent of open access in successive phases and
determining the wheeling charges

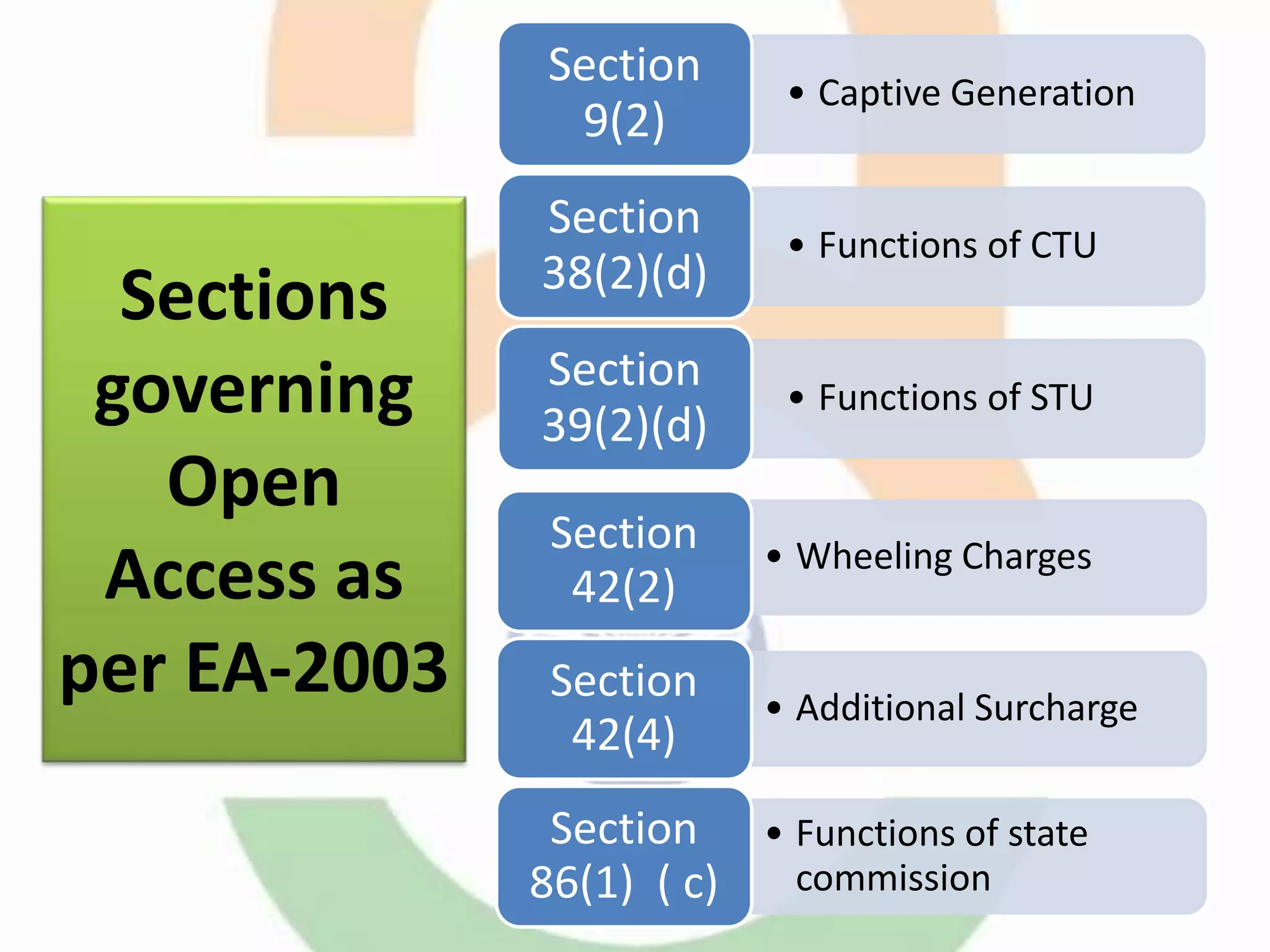

Sections
governing
Open
Access as
per EA-2003
• Captive Generation
Section
9(2)
• Functions of CTU
Section
38(2)(d)
• Functions of STU
Section
39(2)(d)
• Wheeling Charges
Section
42(2)
• Additional Surcharge
Section
42(4)
• Functions of state
commission
Section
86(1) ( c)

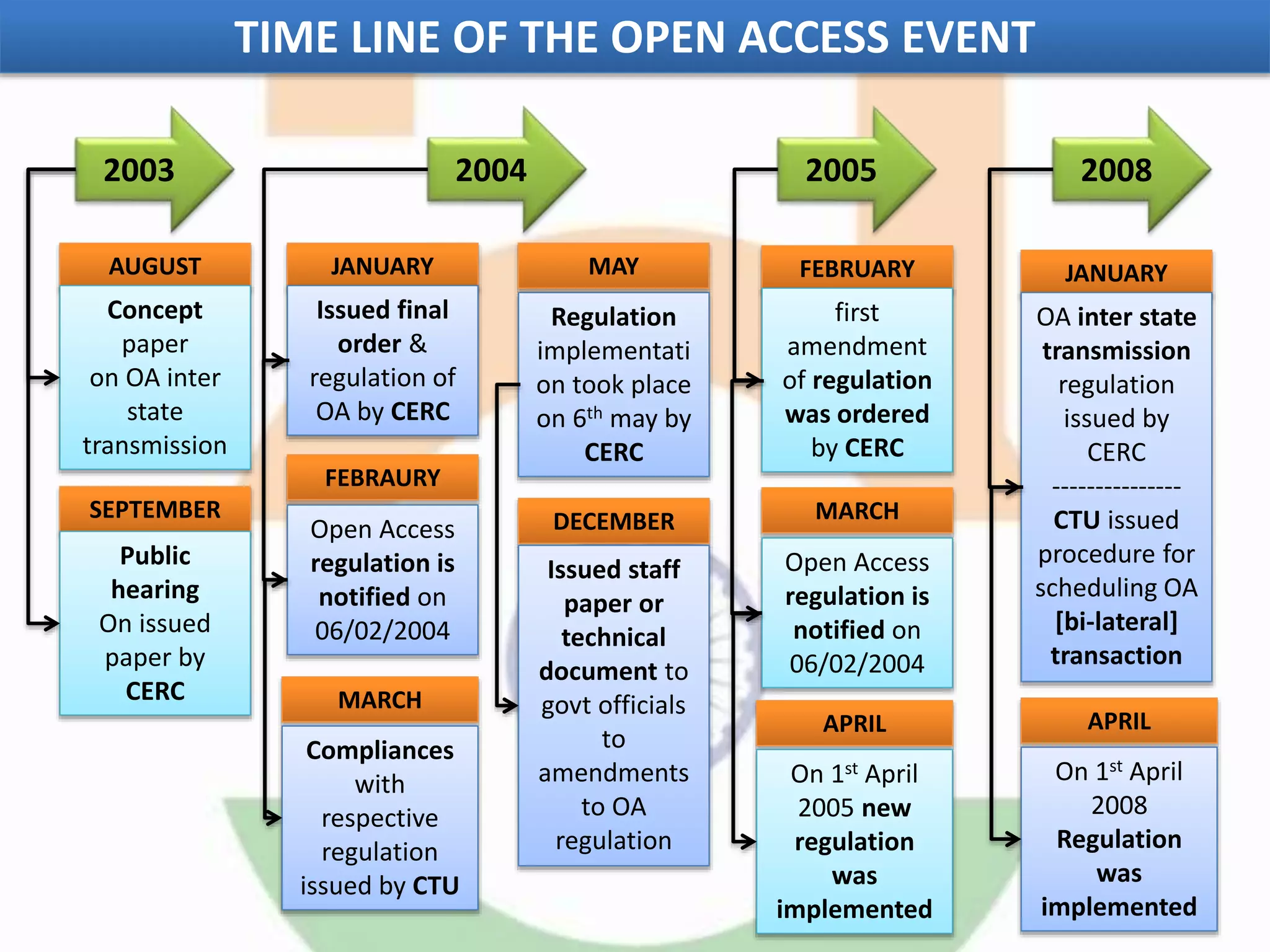

AUGUST
Concept
paper
on OA inter
state
transmission
SEPTEMBER
2003
Public
hearing
On issued
paper by
CERC
JANUARY
Issued final
order &
regulation of
OA by CERC
MARCH
Compliances
with
respective
regulation
issued by CTU
FEBRAURY
Open Access
regulation is
notified on
06/02/2004
2004 2005 2008
MAY
Regulation
implementati
on took place
on 6th may by
CERC
DECEMBER
Issued staff
paper or
technical
document to
govt officials
to
amendments
to OA
regulation
FEBRUARY
first
amendment
of regulation
was ordered
by CERC
APRIL
On 1st April
2005 new
regulation
was
implemented
MARCH
Open Access
regulation is
notified on
06/02/2004
TIME LINE OF THE OPEN ACCESS EVENT
JANUARY
OA inter state
transmission
regulation
issued by
CERC
---------------
CTU issued
procedure for
scheduling OA
[bi-lateral]
transaction
APRIL
On 1st April
2008
Regulation
was
implemented
2013
These regulations may be called the Central Electricity Regulatory
Commission (Open Access in inter-State Transmission) (Second
Amendment) Regulations, 2013.
Grant of Connectivity, Long-term Access and Medium-term Open Access in
inter-State Transmission and related matters

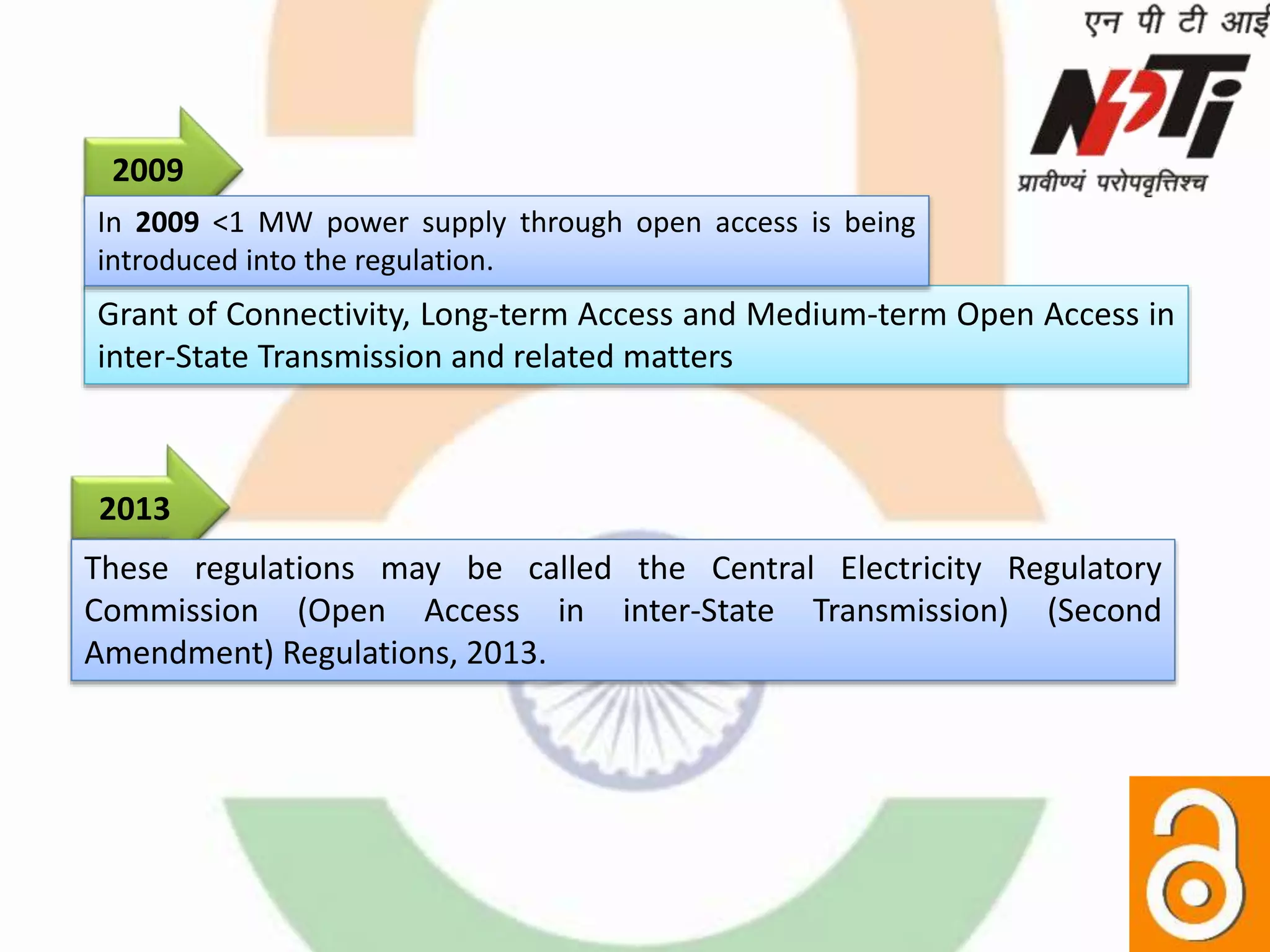

2009
In 2009 <1 MW power supply through open access is being
introduced into the regulation.
Processing of Application
For Short-Term Customers
• Nodal RLDC to interact with concerned RLDCs/SLDCs
to process the same in specified time period.
• Processing time as per CERC Order
• Up-to One Day : 12 Hours
• Up-to One Week : 2 days
• Up-to One month : 7 days
• Up-to One year : 30 days
• Applicant to furnish details of transactions like point
of injection/drawal, quantum (MW), duration, along-
with necessary payments.

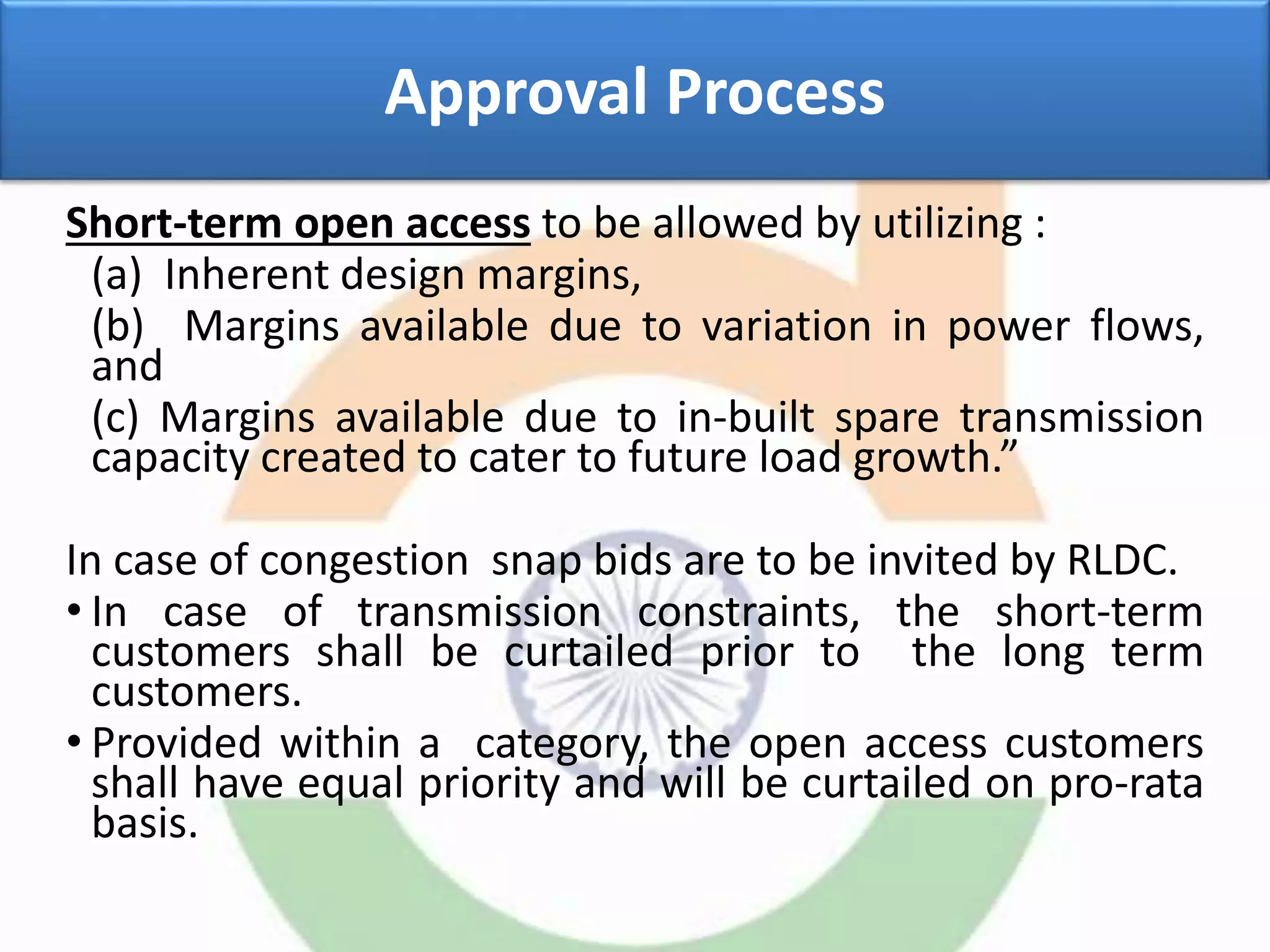

Approval Process
Short-term open access to be allowed by utilizing :
(a) Inherent design margins,
(b) Margins available due to variation in power flows,
and
(c) Margins available due to in-built spare transmission
capacity created to cater to future load growth.”
In case of congestion snap bids are to be invited by RLDC.
• In case of transmission constraints, the short-term
customers shall be curtailed prior to the long term
customers.
• Provided within a category, the open access customers
shall have equal priority and will be curtailed on pro-rata
basis.

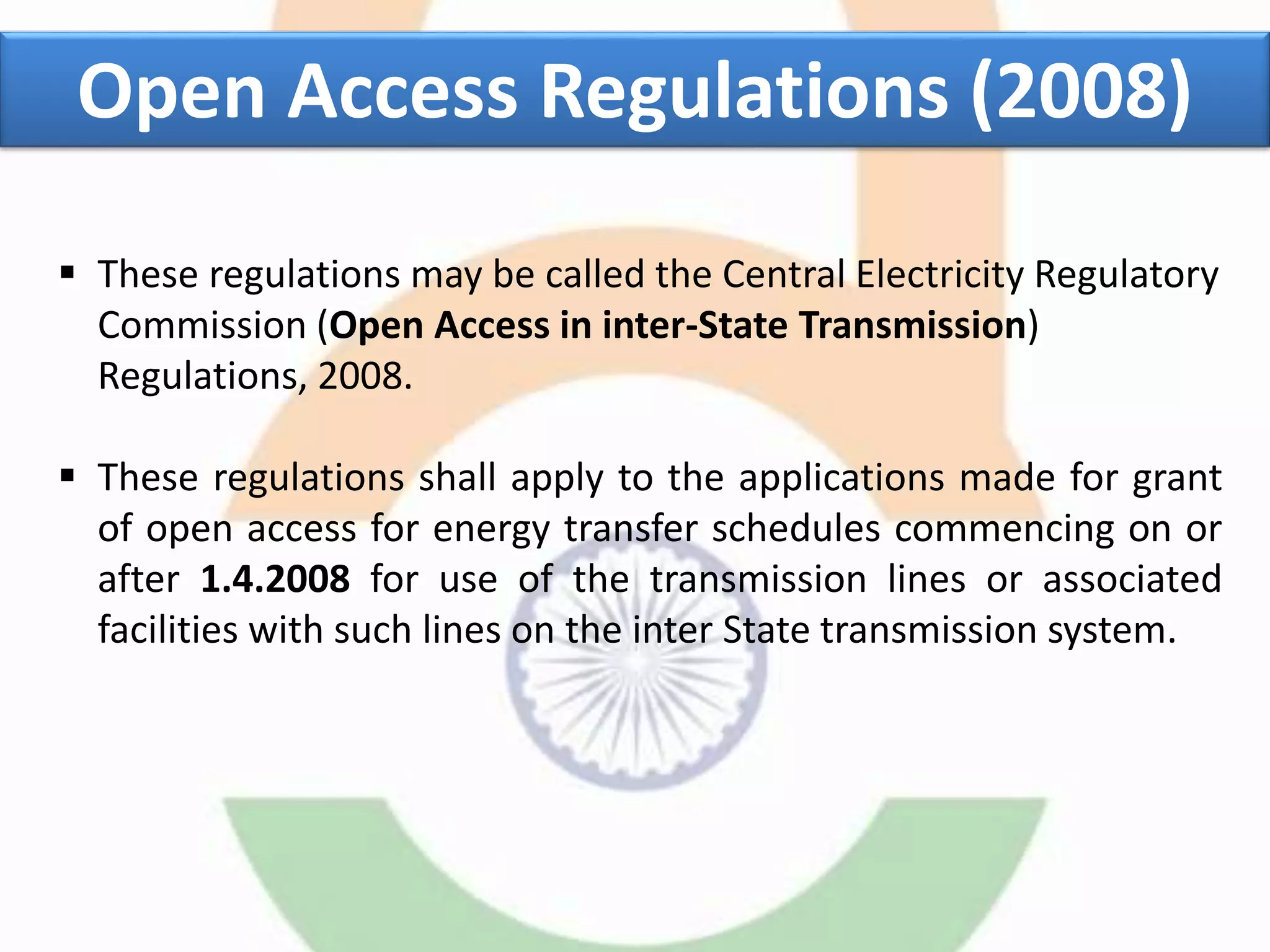

Open Access Regulations
(2008)
 These regulations may be called the Central Electricity Regulatory
Commission (Open Access in inter-State Transmission)
Regulations, 2008.
 These regulations shall apply to the applications made for grant
of open access for energy transfer schedules commencing on or
after 1.4.2008 for use of the transmission lines or associated
facilities with such lines on the inter State transmission system.
Open Access Regulations (2008)

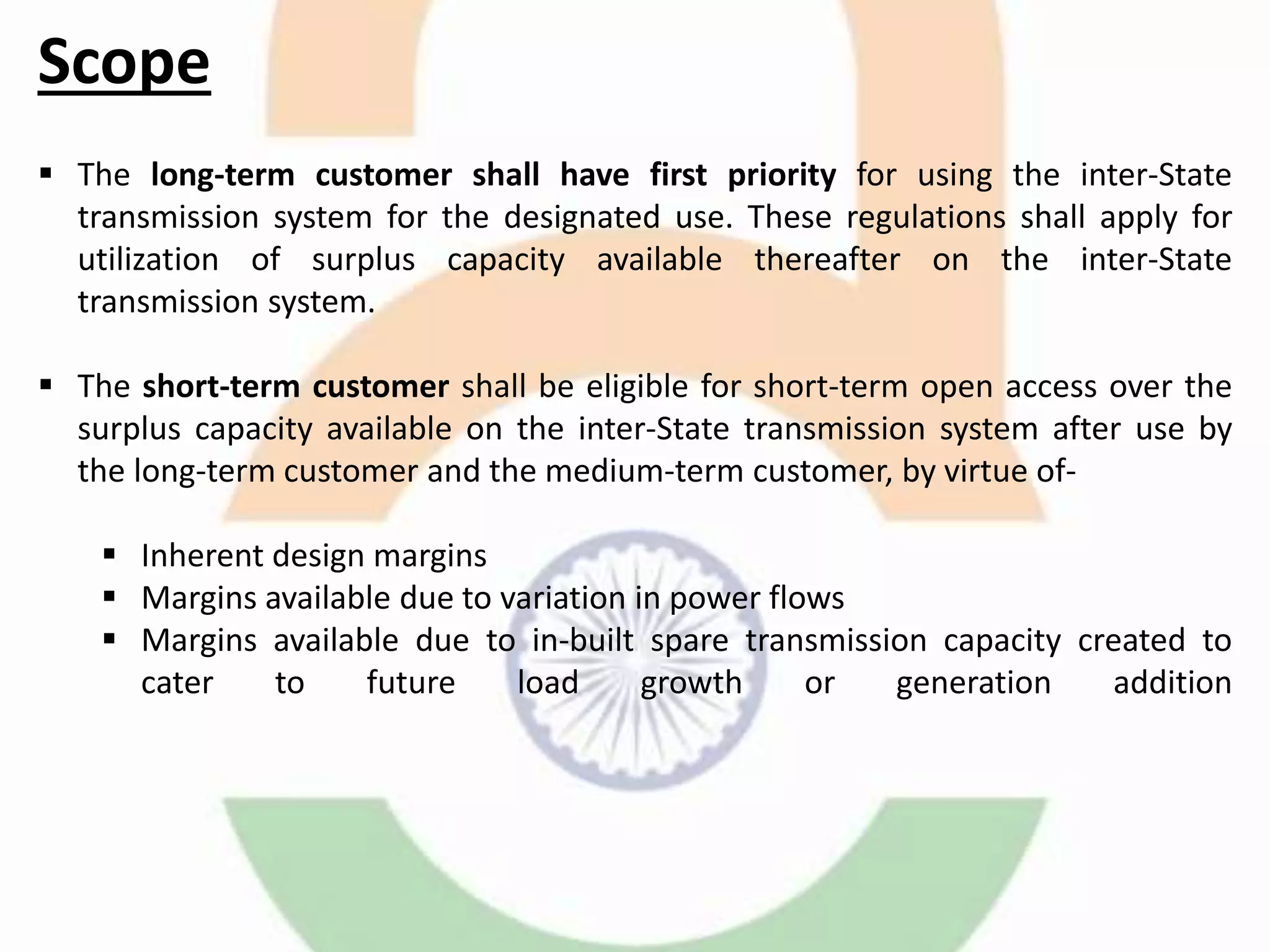

Scope
 The long-term customer shall have first priority for using the inter-State
transmission system for the designated use. These regulations shall apply for
utilization of surplus capacity available thereafter on the inter-State
transmission system.
 The short-term customer shall be eligible for short-term open access over the
surplus capacity available on the inter-State transmission system after use by
the long-term customer and the medium-term customer, by virtue of-
 Inherent design margins
 Margins available due to variation in power flows
 Margins available due to in-built spare transmission capacity created to
cater to future load growth or generation addition

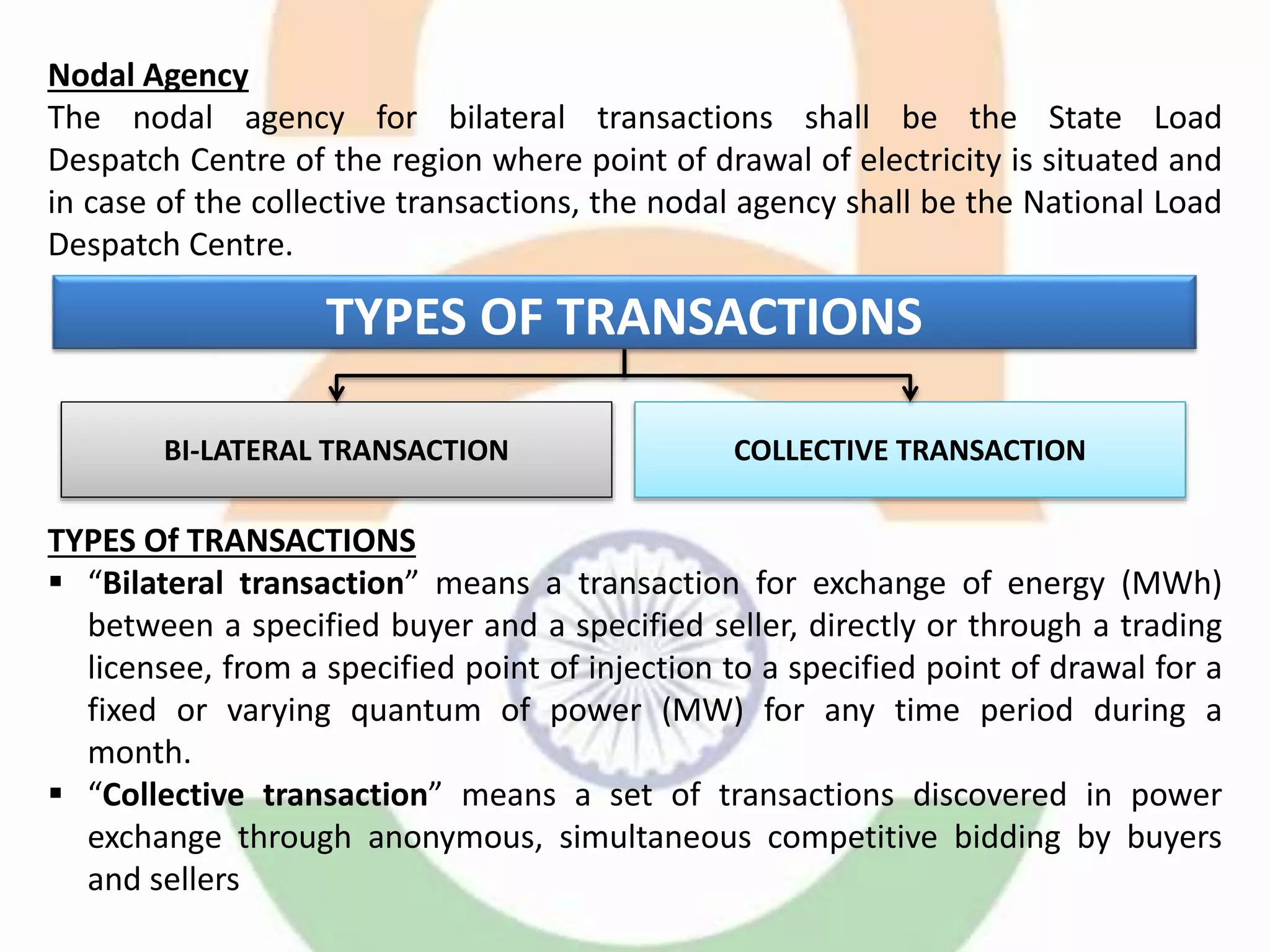

Nodal Agency
The nodal agency for bilateral transactions shall be the State Load
Despatch Centre of the region where point of drawal of electricity is situated and
in case of the collective transactions, the nodal agency shall be the National Load
Despatch Centre.
TYPES Of TRANSACTIONS
 “Bilateral transaction” means a transaction for exchange of energy (MWh)
between a specified buyer and a specified seller, directly or through a trading
licensee, from a specified point of injection to a specified point of drawal for a
fixed or varying quantum of power (MW) for any time period during a
month.
 “Collective transaction” means a set of transactions discovered in power
exchange through anonymous, simultaneous competitive bidding by buyers
and sellers
TYPES OF TRANSACTIONS
BI-LATERAL TRANSACTION COLLECTIVE TRANSACTION
Type of Transaction Transmission charges (Total)
(Rs./MWh)
Bilateral, intra-regional 30
Bilateral, between adjacent regions 60
Bilateral, wheeling through one or more
intervening regions
90
Transmission Charges ( Long-term and medium-term OA) :
 In case of bilateral transactions, for use of the inter-State transmission
system, the transmission charges at the rate specified :
 In case of the collective transaction, for use of the inter-State
transmission system, transmission charges at the rate of Rs.30/MWh for
energy approved for transmission for each point of injection and for each point
of drawal shall be payable.

Type of Transaction Transmission charges (Total)
(Rs./MWh)
Bilateral, intra-regional 80
Bilateral, between adjacent regions 160
Bilateral, wheeling through one or more
intervening regions
240

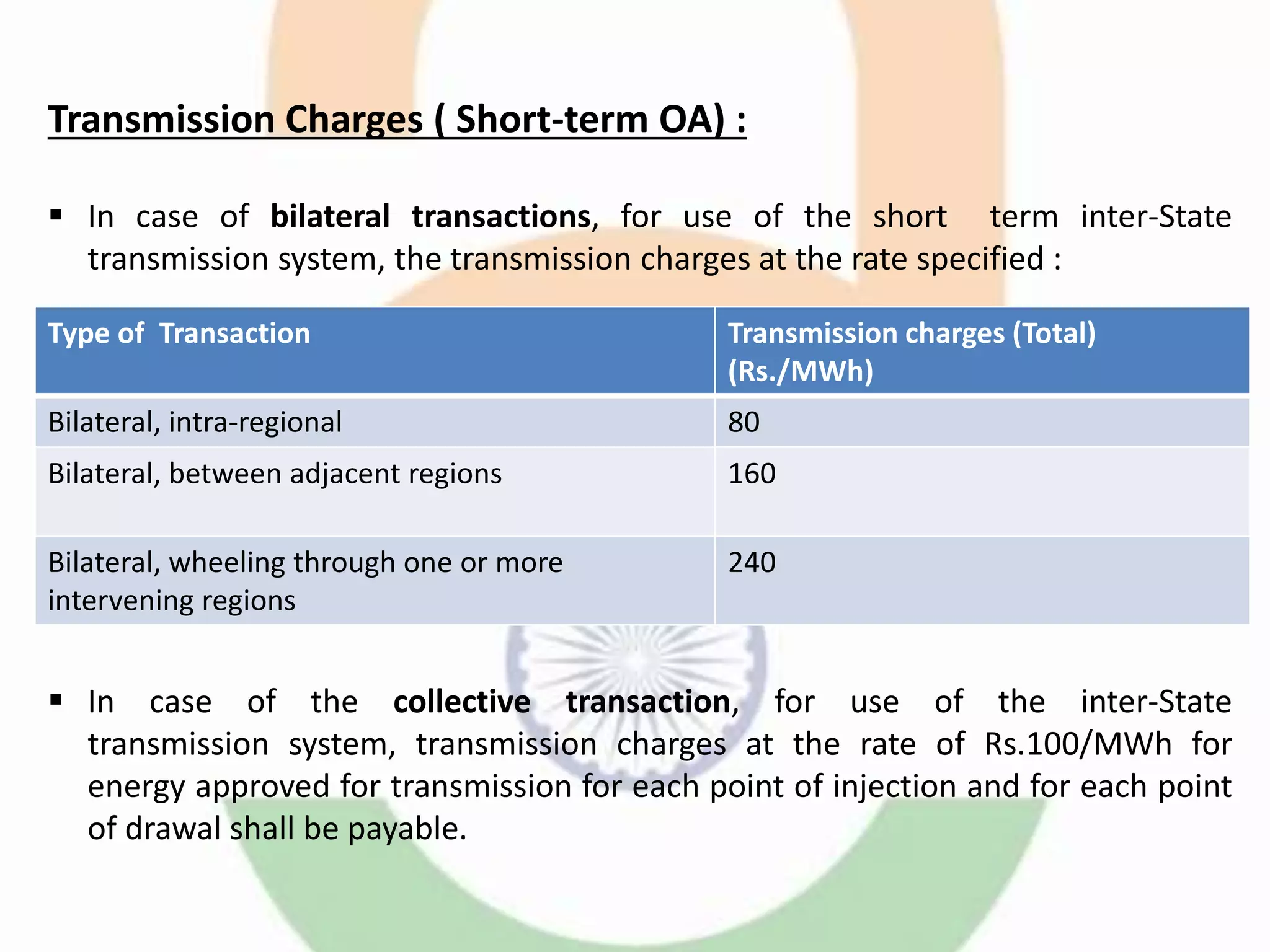

Transmission Charges ( Short-term OA) :
 In case of bilateral transactions, for use of the short term inter-State
transmission system, the transmission charges at the rate specified :
 In case of the collective transaction, for use of the inter-State
transmission system, transmission charges at the rate of Rs.100/MWh for
energy approved for transmission for each point of injection and for each point
of drawal shall be payable.

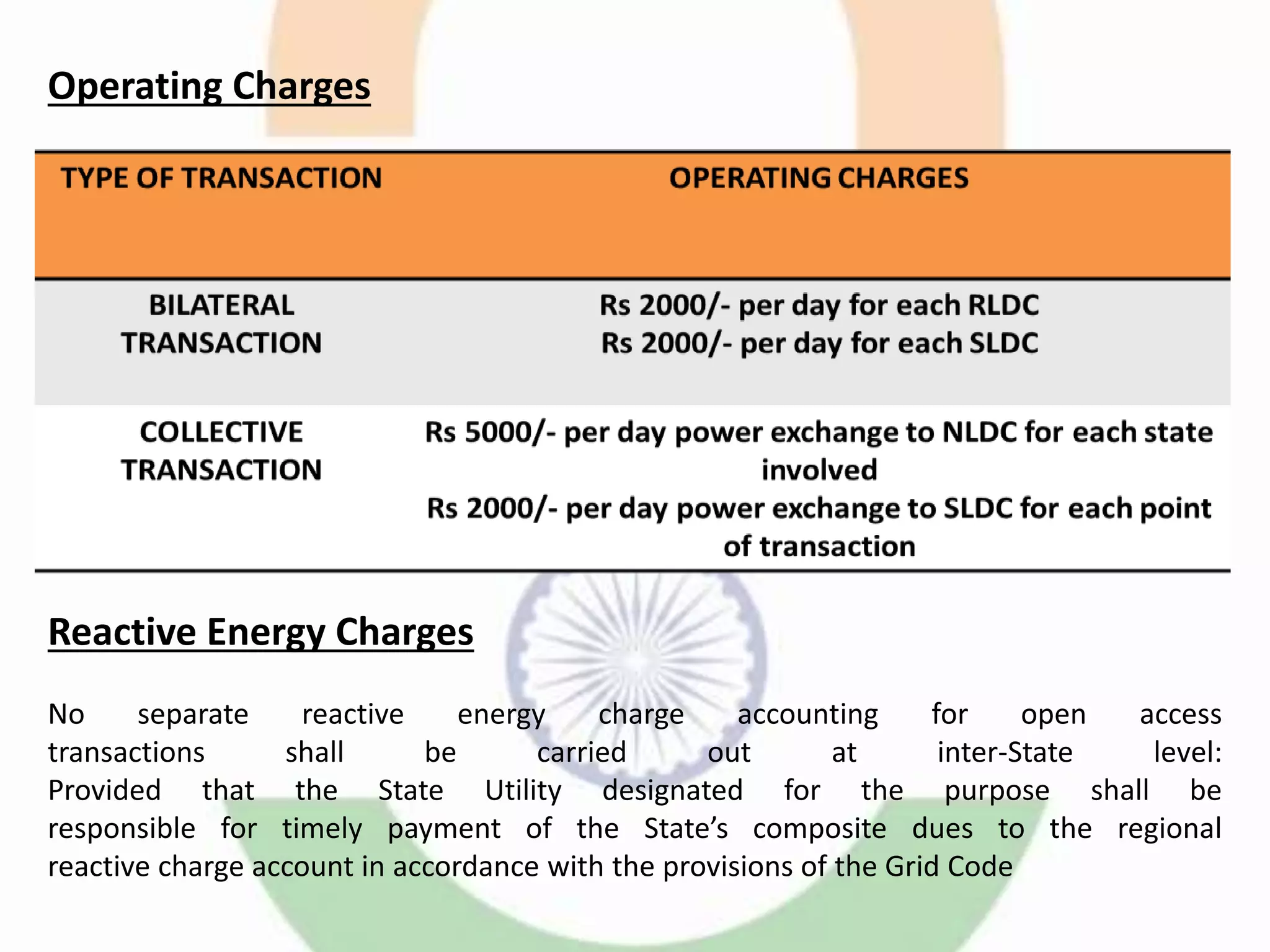

Operating Charges
Reactive Energy Charges
No separate reactive energy charge accounting for open access
transactions shall be carried out at inter-State level:
Provided that the State Utility designated for the purpose shall be
responsible for timely payment of the State’s composite dues to the regional
reactive charge account in accordance with the provisions of the Grid Code

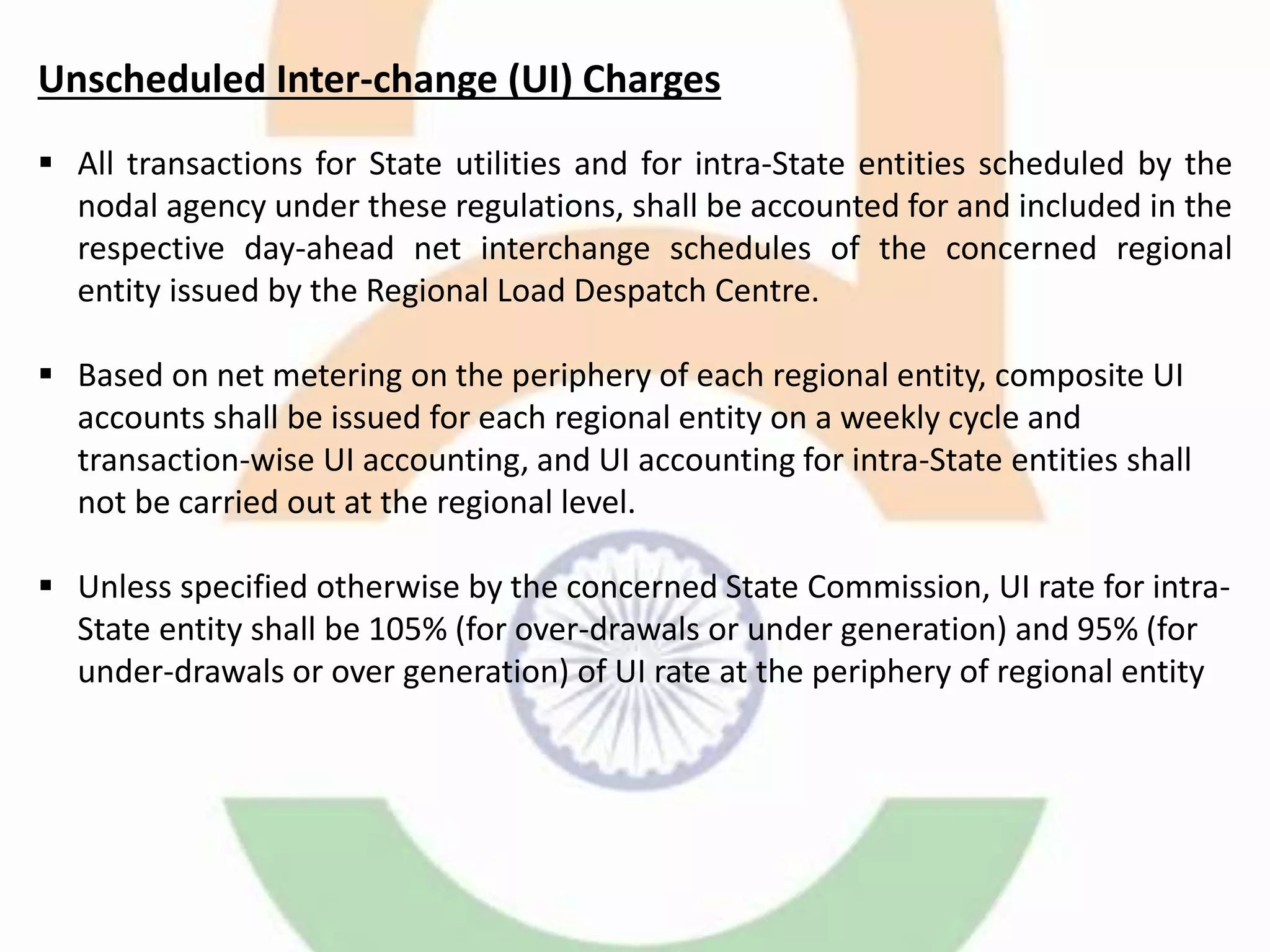

Unscheduled Inter-change (UI) Charges
 All transactions for State utilities and for intra-State entities scheduled by the
nodal agency under these regulations, shall be accounted for and included in the
respective day-ahead net interchange schedules of the concerned regional
entity issued by the Regional Load Despatch Centre.
 Based on net metering on the periphery of each regional entity, composite UI
accounts shall be issued for each regional entity on a weekly cycle and
transaction-wise UI accounting, and UI accounting for intra-State entities shall
not be carried out at the regional level.
 Unless specified otherwise by the concerned State Commission, UI rate for intra-
State entity shall be 105% (for over-drawals or under generation) and 95% (for
under-drawals or over generation) of UI rate at the periphery of regional entity

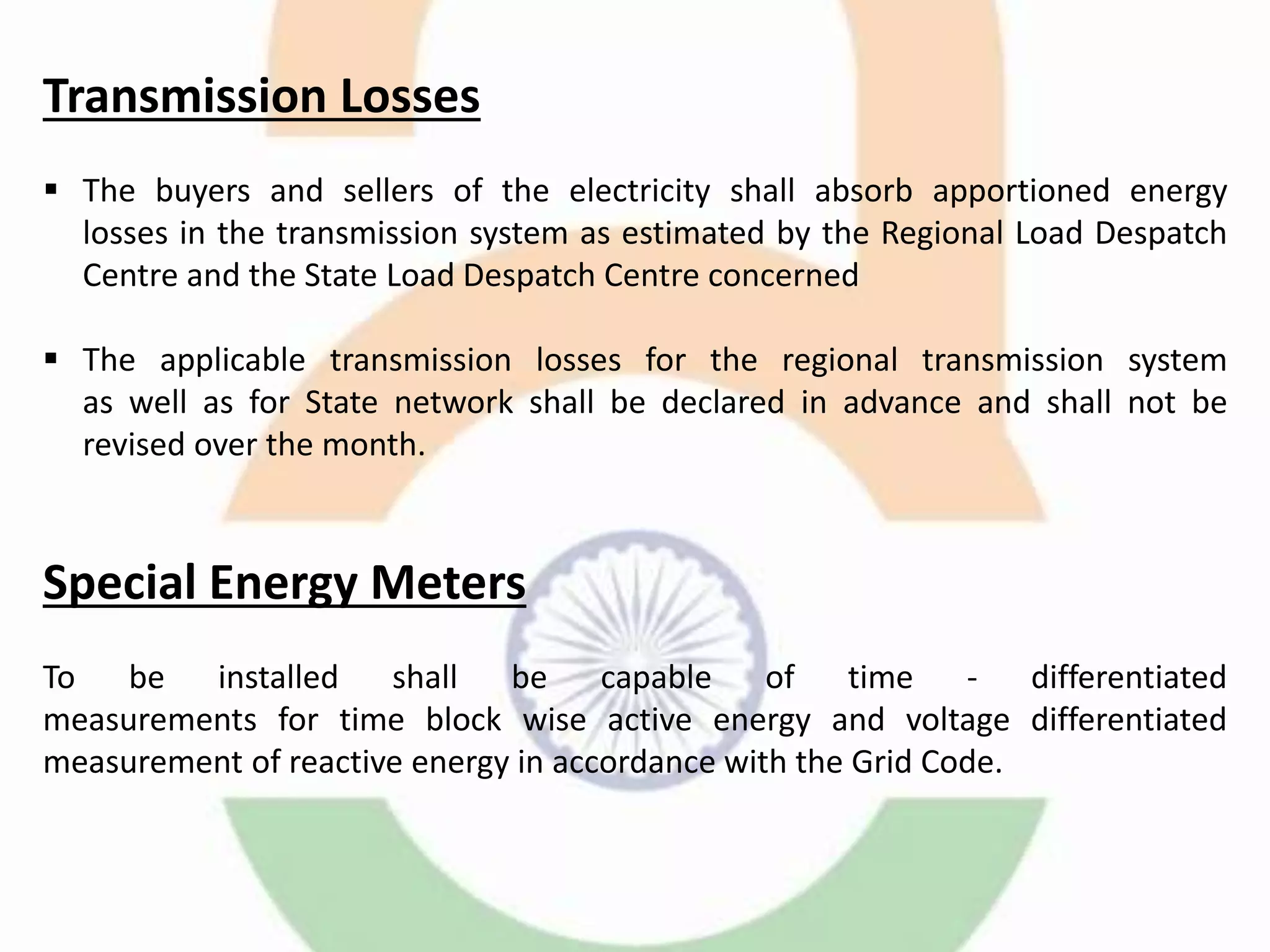

Transmission Losses
 The buyers and sellers of the electricity shall absorb apportioned energy
losses in the transmission system as estimated by the Regional Load Despatch
Centre and the State Load Despatch Centre concerned
 The applicable transmission losses for the regional transmission system
as well as for State network shall be declared in advance and shall not be
revised over the month.
Special Energy Meters
To be installed shall be capable of time - differentiated
measurements for time block wise active energy and voltage differentiated
measurement of reactive energy in accordance with the Grid Code.
Redressal Mechanism
Unless the dispute involves the State Load Despatch Centre and the intra-State
entities of the concerned State and falls within the jurisdiction of the State
Commission, all disputes arising under these regulations shall be decided by
the Commission based on an application made by the person aggrieved.
 When so directed by the Commission, the National Load Despatch Centre or the
Regional Load Despatch Centre, as the case may be, shall not grant short-term
open access to the entities and associates of such entities, who consistently and
willfully default in payment of Unscheduled Interchange charges, transmission
charges, reactive energy charges, congestion charges and fee and charges for
National Load Despatch Centre or Regional Load Despatch Centre including the
charges for the Unified Load Despatch and Communication Scheme .

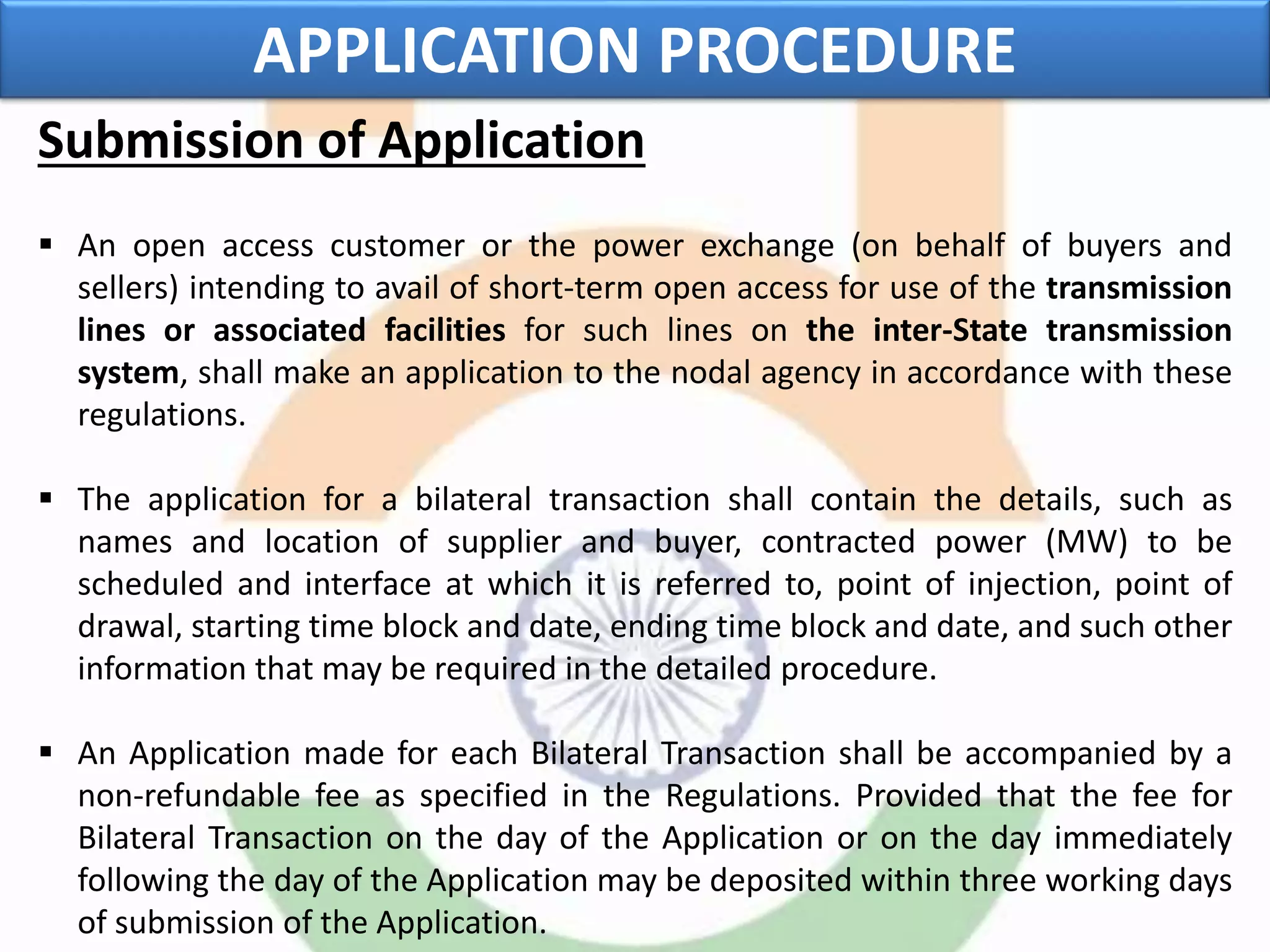

Submission of Application
 An open access customer or the power exchange (on behalf of buyers and
sellers) intending to avail of short-term open access for use of the transmission
lines or associated facilities for such lines on the inter-State transmission
system, shall make an application to the nodal agency in accordance with these
regulations.
 The application for a bilateral transaction shall contain the details, such as
names and location of supplier and buyer, contracted power (MW) to be
scheduled and interface at which it is referred to, point of injection, point of
drawal, starting time block and date, ending time block and date, and such other
information that may be required in the detailed procedure.
 An Application made for each Bilateral Transaction shall be accompanied by a
non-refundable fee as specified in the Regulations. Provided that the fee for
Bilateral Transaction on the day of the Application or on the day immediately
following the day of the Application may be deposited within three working days
of submission of the Application.
APPLICATION PROCEDURE
CONTINUE..
A copy of the Application shall be endorsed by the applicant to the following:
a) Each RLDC involved in the transaction
b) Each SLDC involved in the transaction
Application Fee
 An application made for each bilateral transaction or the collective transaction
shall be accompanied by a non-refundable fee of Rupees five thousand
(Rs.5000/- ) only
 Provided that the fee for bilateral transaction on the day of the application or on
the day immediately following the day of the application may be deposited
within three working days of submission of the application.

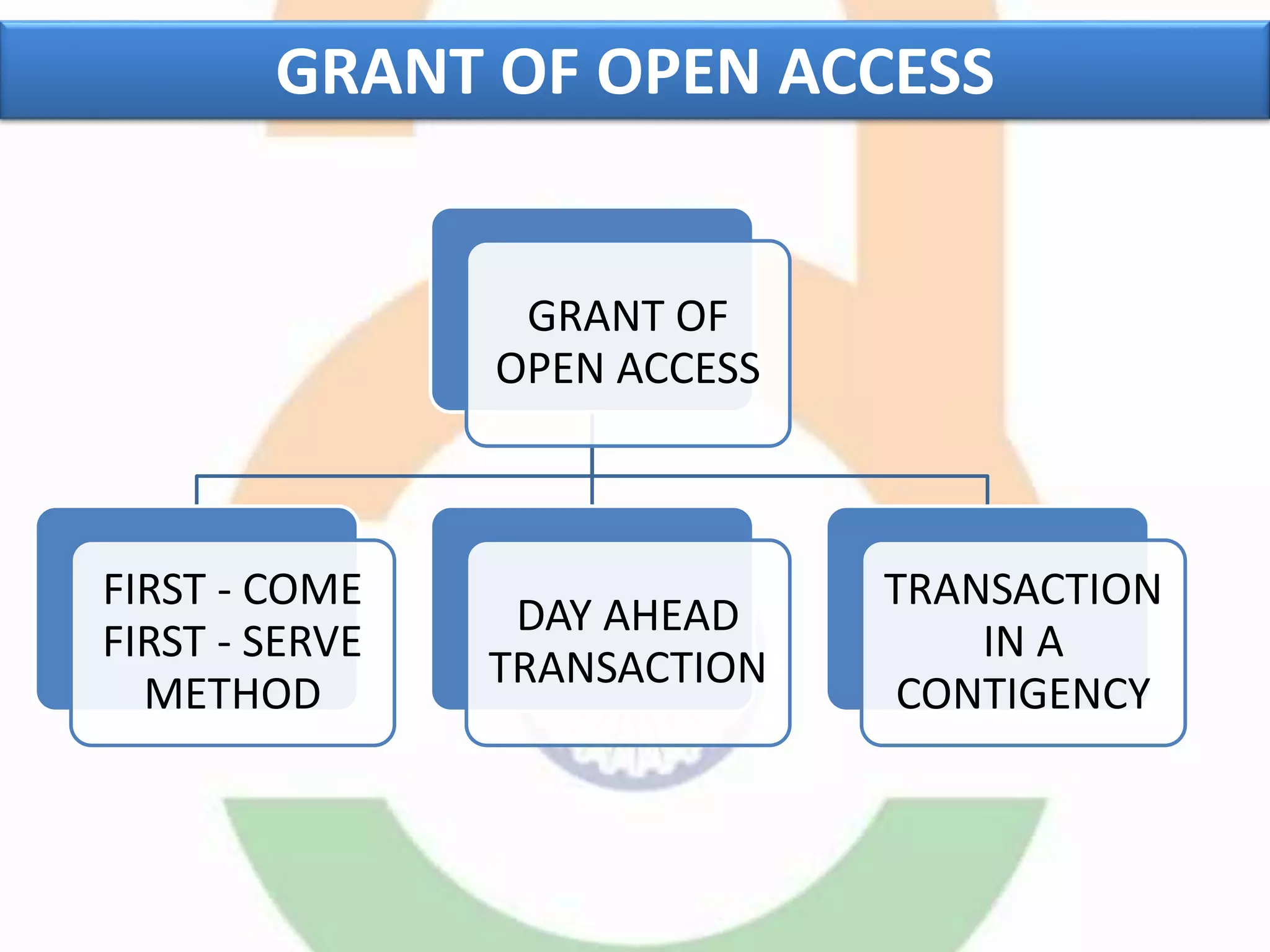

GRANT OF
OPEN ACCESS
FIRST - COME
FIRST - SERVE
METHOD
DAY AHEAD
TRANSACTION
TRANSACTION
IN A
CONTIGENCY
GRANT OF OPEN ACCESS
Where in the opinion of the nodal agency, grant of all applications at a
particular stage of advance scheduling is likely to cause congestion in one or
more of the transmission corridors to be used, it shall conduct electronic
bidding for grant of for the available surplus transmission capacity among
the applicants at that stage, in accordance with the detailed procedure
Provided that if any person does not participate in the bidding process he
shall be deemed to have withdrawn his application
Congestion Management

These regulations may be called the Central Electricity Regulatory
Commission (Grant of Connectivity, Long-term Access and
Medium-term Open Access in inter-State Transmission and
related matters) Regulations, 2009.
• The amendments were proposed to be effective from
1.4.2009.
• However, It was also felt that the Central Transmission Utility
would require some time to amend the existing detailed the
Commission decided that the amended regulations shall apply
to all the applications for grant of open access received by the
nodal agencies on or after 15.6.2009.
Open access 2009
Scope
The grant of connectivity, long-term access and medium-term open access, in
respect of inter-State transmission system:
 Provided that a generating station, including captive generating plant or a
bulk consumer, seeking connectivity to the inter-State transmission system
cannot apply for long-term access or medium term open access without
applying for connectivity
 Provided further that a person may apply for connectivity and long-term
access or medium-term open access simultaneously.
Nodal Agency
The nodal agency for grant of connectivity, long-term access and medium term
open access to the inter-State transmission system shall be the Central
Transmission Utility.
State-wise Open Access Consumers at IEX
(As on 30th June 2013)
State Generators Consumers
Jammu & Kashmir 3 0
Himachal Pradesh 3 1
Punjab 2 303
Haryana 1 146
Uttarakhand 1 40
Rajasthan 13 121
Madhya Pradesh 10 11
Gujarat 20 225
Maharashtra 10 3
Goa 1 0
Orissa 11 1
Chhattisgarh 10 0
West Bengal 2 0
Arunachal Pradesh 1 4
Meghalaya 3 2
Karnataka 45 26
Andhra Pradesh 22 597
Tamil Nadu 0 499
Kerala 0 8
Others 30 1
Total 178 1988
State-wise Open Access Consumers at IEX
(As on 30th June 2013)
597
499
303
226
146
121
40
26
11 8 4 3 5
0
100
200
300
400
500
600
700
No.ofOpenAccessConsumers
State-wise OA Consumers at IEX
Today almost 2000 plus consumers are availing OA through IEX
Open Access Charges
i. Connectivity Charges
ii. PoC Charges [Point of Connection]
iii. Transmission Charges includes reactive charges
iv. Transmission Losses
v. Wheeling Charges
vi. Wheeling Losses
vii. Cross Subsidy Surcharge
viii. SLDC Charges
ix. RLDC Charges
***In addition to these charges the open access consumers has also to fulfil the renewable purchase
obligation (RPO), in which they have to purchase a part of their total consumption through electricity
generated from renewable energy.
SOURCE: http://indianpowersector.com/home/open-access/oa-charges/#
PHASES OF OPEN ACCESS
• Open Access in Transmission shall be allowed
immediately.
• Open Access in Distribution system shall be in Phases.
A. Delivering of electricity to >= 5MW load consumers
B. Delivering of electricity to >= 3MW load consumers
C. Delivering of electricity to >= 1MW load consumers
• The commission may allow open access to consumers
with capacity requirement less than one MW subject
to review of the operational constraints and other
factors. (DERC terms and Cond)

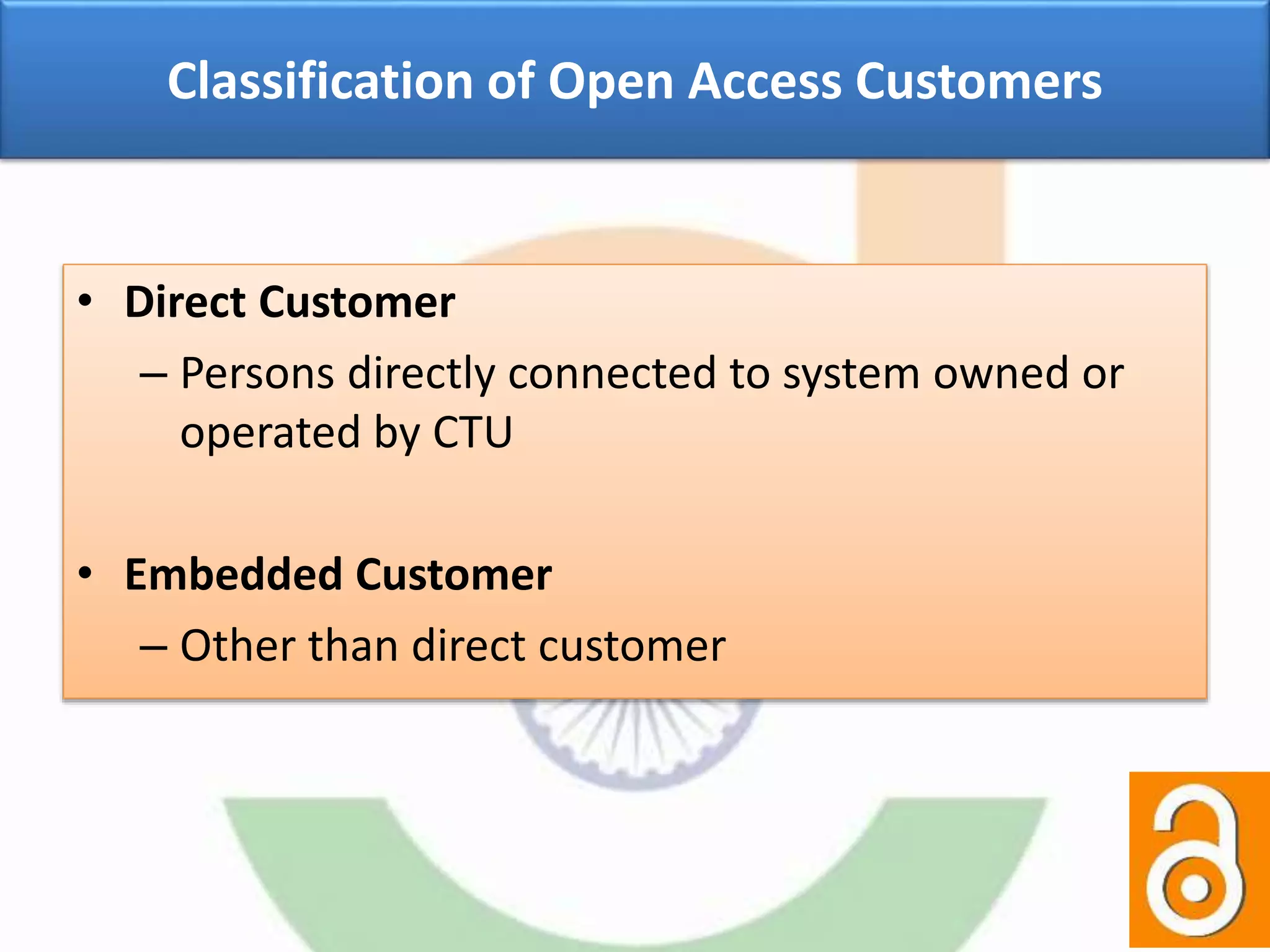

Classification of Open Access Customers
• Direct Customer
– Persons directly connected to system owned or
operated by CTU
• Embedded Customer
– Other than direct customer

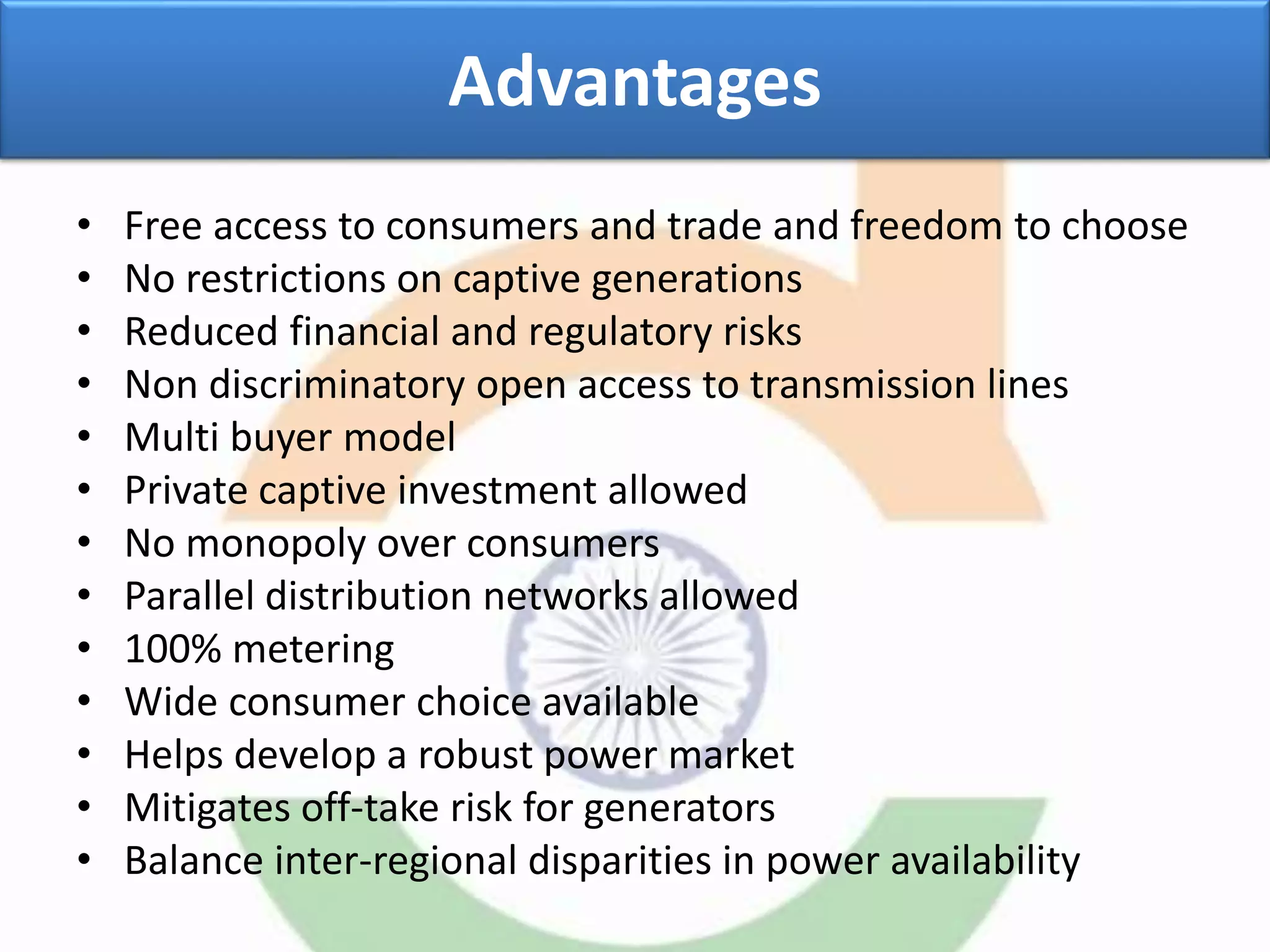

Advantages
• Free access to consumers and trade and freedom to choose
• No restrictions on captive generations
• Reduced financial and regulatory risks
• Non discriminatory open access to transmission lines
• Multi buyer model
• Private captive investment allowed
• No monopoly over consumers
• Parallel distribution networks allowed
• 100% metering
• Wide consumer choice available
• Helps develop a robust power market
• Mitigates off-take risk for generators
• Balance inter-regional disparities in power availability

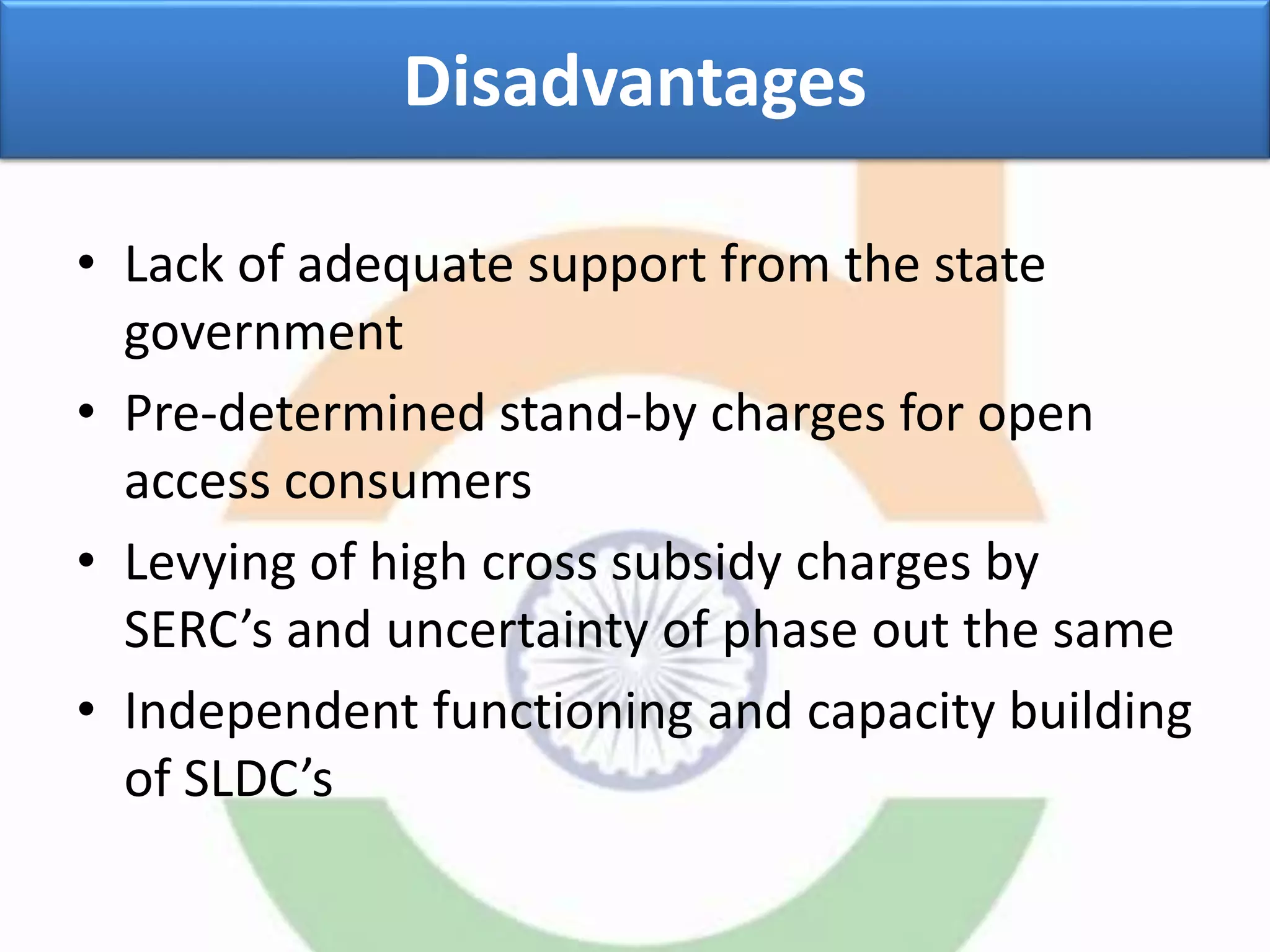

Disadvantages
• Lack of adequate support from the state
government
• Pre-determined stand-by charges for open
access consumers
• Levying of high cross subsidy charges by
SERC’s and uncertainty of phase out the same
• Independent functioning and capacity building
of SLDC’s
Opportunities
1. For Generating Companies
• No license required for developing a generating station
• could sell power to any person through open access
• Easy change in purchaser in the event of default in honoring the
contract by the purchaser.
2. For consumers
• Buy power from anywhere – could explore cheaper sources specially
useful for high demand industrial / commercial consumers.
• Industrial houses could consolidate power supply to plants at various
locations and build captive power plant to achieve economy
Grant Of Connectivity
Regulations

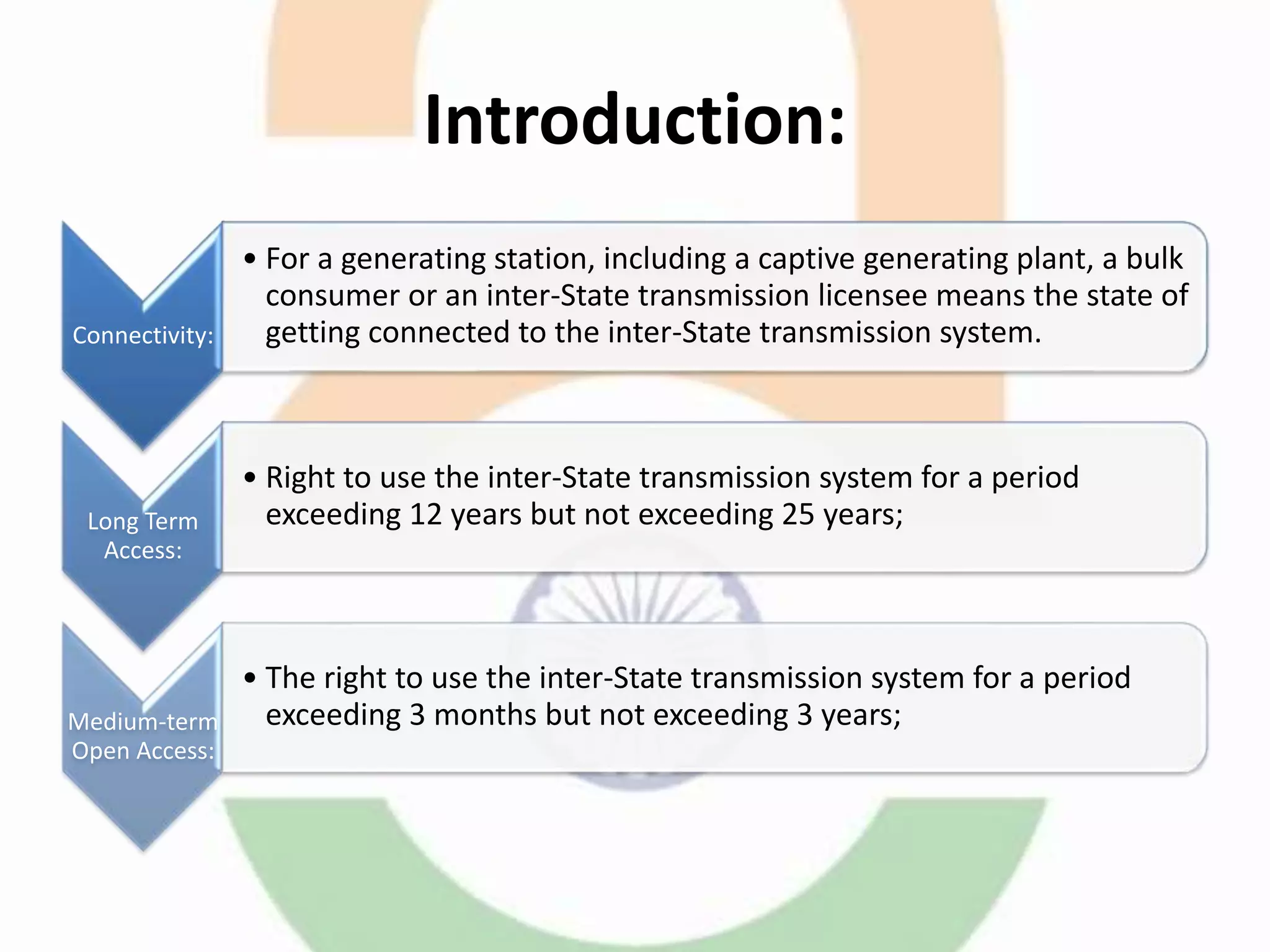

Introduction:
Connectivity:
• For a generating station, including a captive generating plant, a bulk
consumer or an inter-State transmission licensee means the state of
getting connected to the inter-State transmission system.
Long Term
Access:
• Right to use the inter-State transmission system for a period
exceeding 12 years but not exceeding 25 years;
Medium-term
Open Access:
• The right to use the inter-State transmission system for a period
exceeding 3 months but not exceeding 3 years;
Applicant:
• A person may apply for connectivity and long-term
access or medium-term open access
simultaneously.
• Applications for grant of connectivity or long-term
access or medium-term open access shall be made
to the nodal agency (Central Transmission Utility).
• Applicant
– A Generating station of installed capacity >= 250MW
– A Captive Plant of exportable capacity >= 250MW
– A Bulk Consumer : minimum of 100 MW load
– A Distribution Licensee
– An Electricity Trader

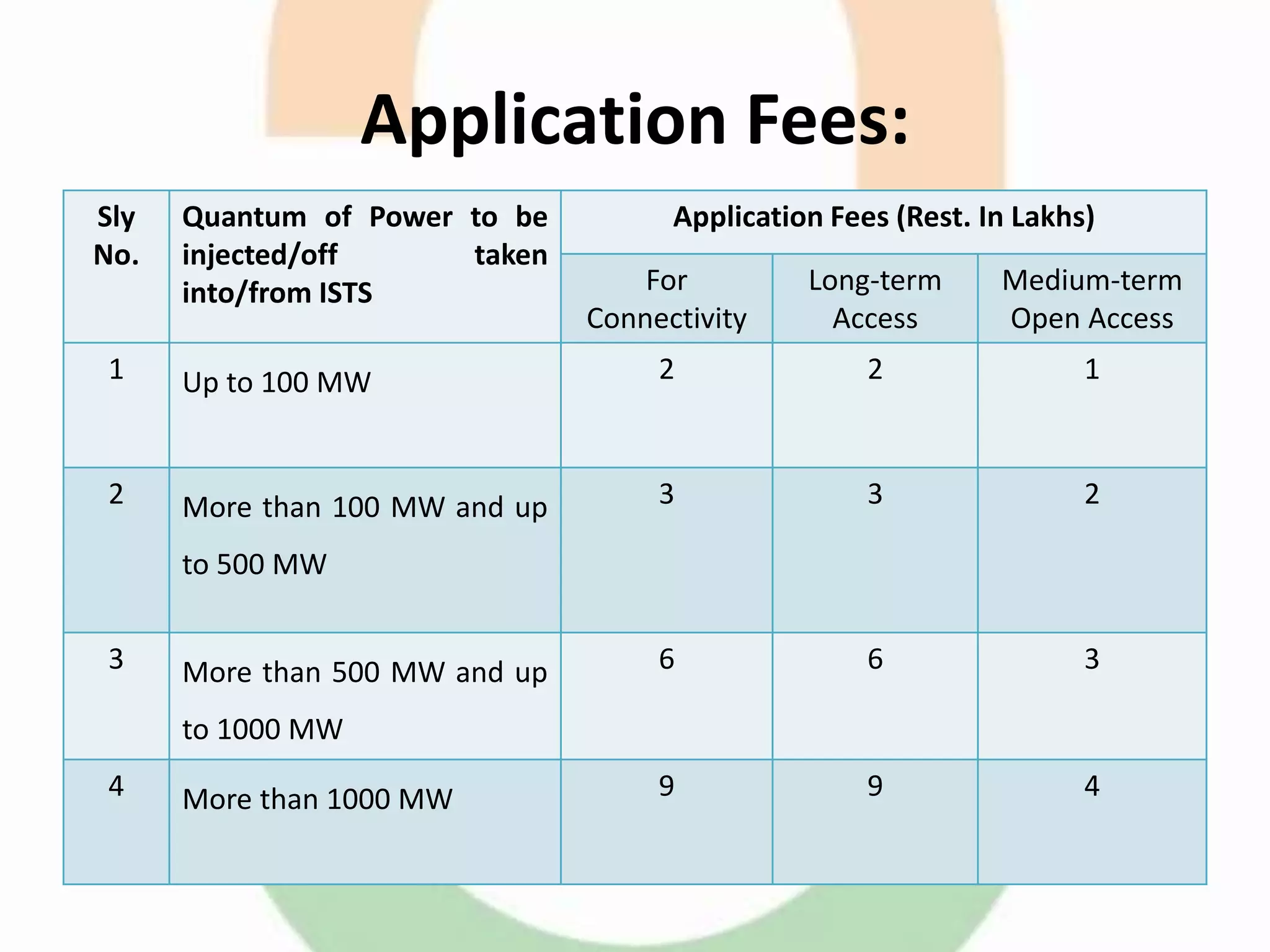

Application Fees:
Sly
No.
Quantum of Power to be
injected/off taken
into/from ISTS
Application Fees (Rest. In Lakhs)
For
Connectivity
Long-term
Access
Medium-term
Open Access
1 Up to 100 MW 2 2 1
2 More than 100 MW and up
to 500 MW
3 3 2
3 More than 500 MW and up
to 1000 MW
6 6 3
4 More than 1000 MW 9 9 4
Timeframe for processing of
application:
Nature Of
Application
Time limit for processing beginning the last day of the month
in which application was received by the nodal agency
Connectivity 60 days
Long-term Access 120 days
where augmentation of transmission system is not required
180 days
where augmentation of transmission system is required
Medium-term
Open Access
40 days

Grant of Connectivity
• The application for connectivity shall contain details such as,
proposed geographical location of the applicant, quantum of power
to be interchanged.
• The nodal agency shall, in consultation and through coordination
with other agencies involved in inter-State transmission system to be
used and the substations or switchyard to be used is also to be
defined .
• The grant of connectivity shall not entitle an applicant to interchange
any power with the grid unless it obtains long-term access, medium-
term open access or short-term open access.
• An applicant may be required by the Central Transmission Utility to
construct a dedicated line to the point of connection to enable
connectivity to the grid.

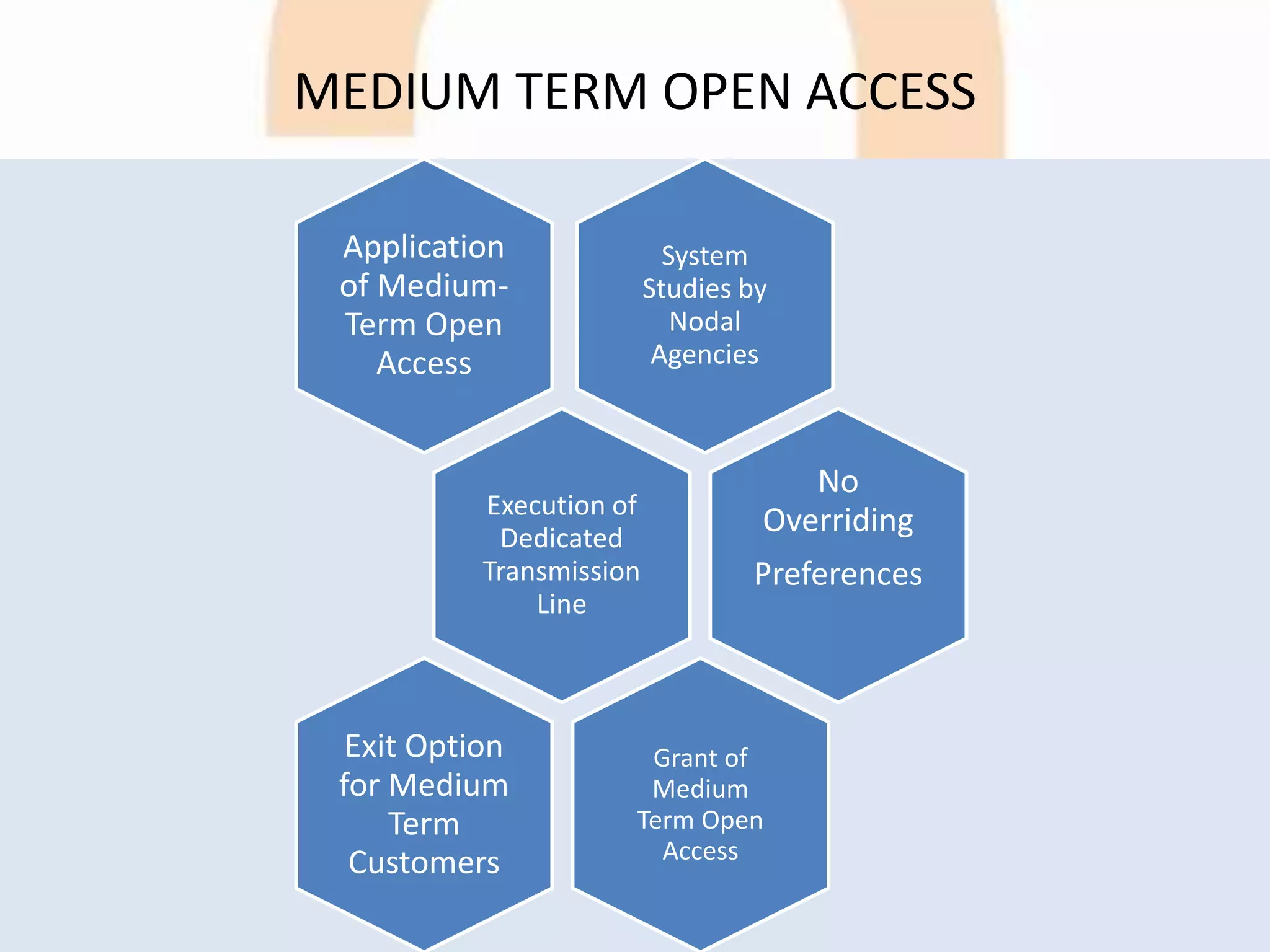

Long Term and Medium Term Open Access
• Criteria for open access-Before awarding long-term access, the
Central Transmission Utility shall have due regard to the
augmentation of inter-State transmission system proposed under the
plans made by the Central Electricity Authority.
• Medium-term open access shall be granted if the resultant power
flow can be accommodated in the existing transmission system or the
transmission system under execution.
• Provided that no augmentation shall be carried out to the
transmission system for the sole purpose of granting medium-term
open access.
Long terms
more priority
First come

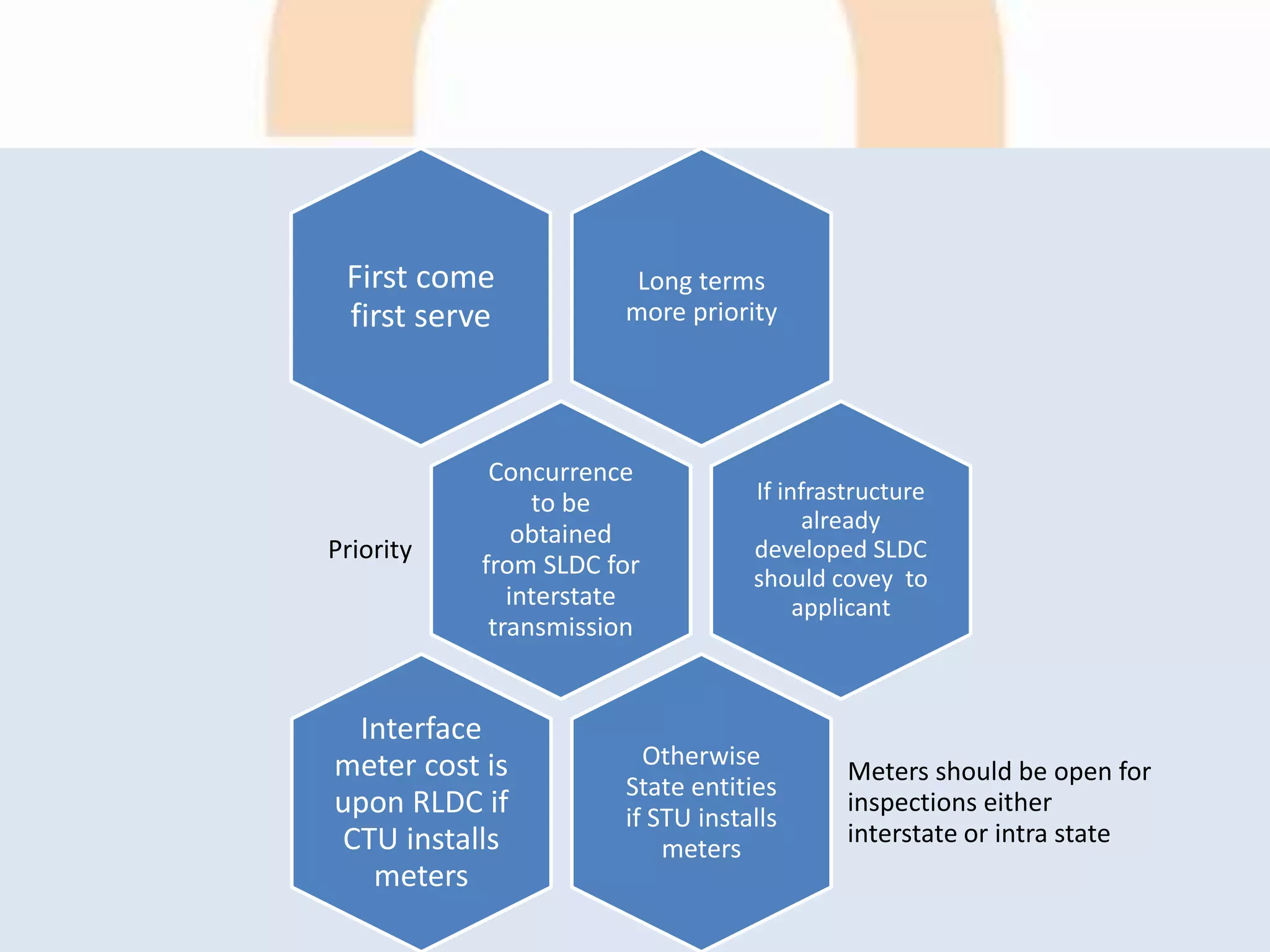

first serve
Concurrence
to be
obtained
from SLDC for
interstate
transmission
Priority
If infrastructure
already
developed SLDC
should covey to
applicant
Otherwise
State entities
if STU installs
meters
Meters should be open for
inspections either
interstate or intra state
Interface
meter cost is
upon RLDC if
CTU installs
meters
Long Term Open Access
• The application for grant of long-term access shall contain details
such as name of the entity or entities to whom electricity is proposed
to be supplied or from whom electricity is proposed to be procured
along with the quantum of power and such other details as may be
laid down by the Central Transmission Utility in the detailed
procedure.
• Provided also that in cases where there is any material change in
location of the applicant or change by more than 100 MW in the
quantum of power to be interchanged using the inter-State
transmission system or change in the region from which electricity is
to be procured or to which supplied, afresh application shall be
made.
• The application shall be accompanied by a bank guarantee of
Rs10,000/- (ten thousand) per MW of the total power to be
transmitted. The bank guarantee shall be in favour of the nodal
agency, in the manner laid down under the detailed procedure.

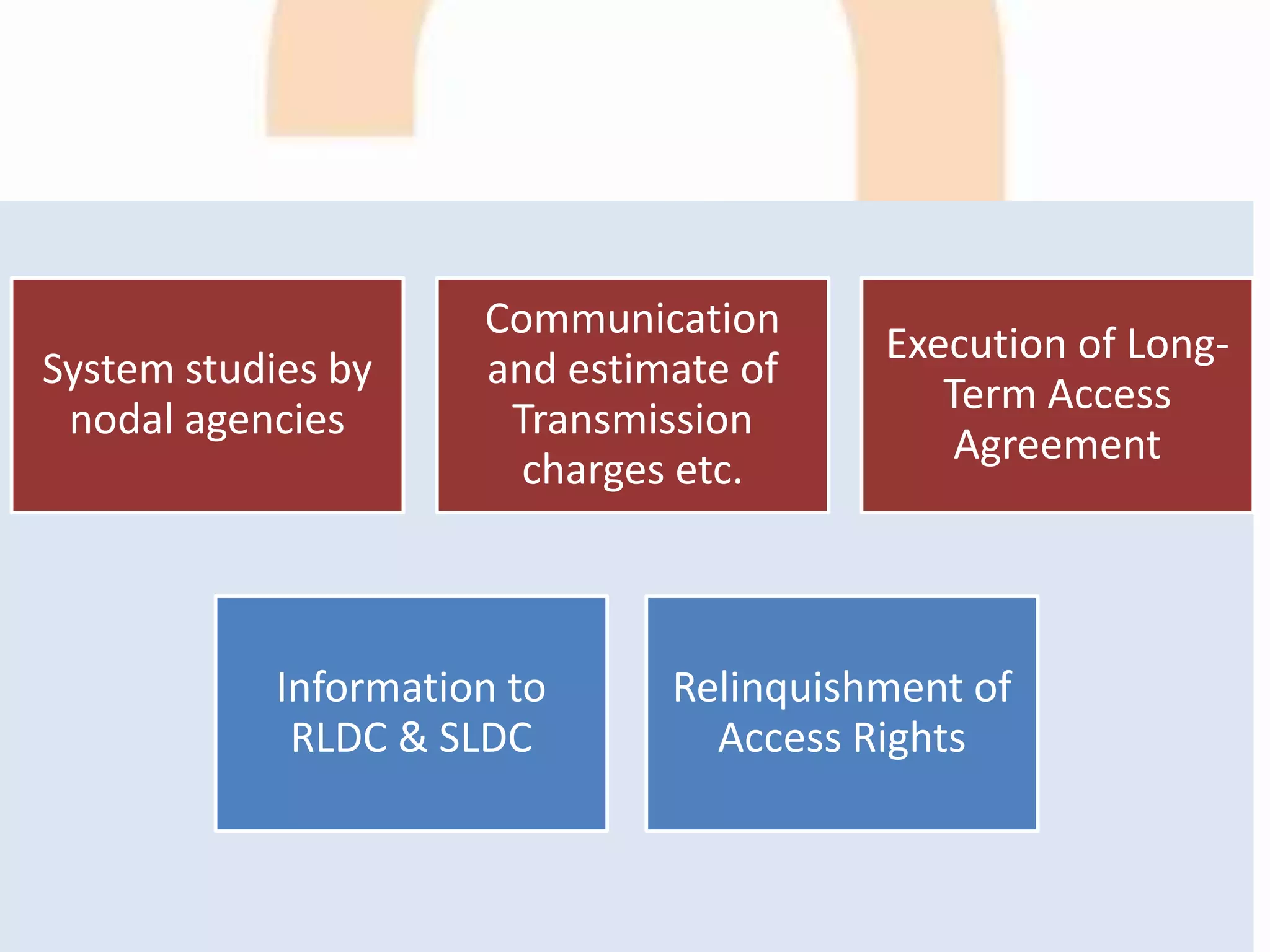

System studies by
nodal agencies
Communication
and estimate of
Transmission
charges etc.
Execution of Long-
Term Access
Agreement
Information to
RLDC & SLDC
Relinquishment of
Access Rights
Execution of Long-Term Access Agreement
• While seeking long-term access to an inter-State transmission
licensee, other than the Central Transmission Utility, the applicant
shall sign a tripartite long-term access agreement with the Central
Transmission Utility and the inter-State transmission licensee.
• The long–term access agreement shall contain the date of
commencement of long-term access, the point of injection of power
into the grid and point of drawal from the grid and the details of
dedicated transmission lines, if any, required.
• Incase augmentation of transmission system is required, the long-
term access agreement shall contain the time line for construction of
the facilities of the applicant and the transmission licensee, the bank
guarantee required to be 18 given by the applicant and other details
in accordance with the detailed procedure.

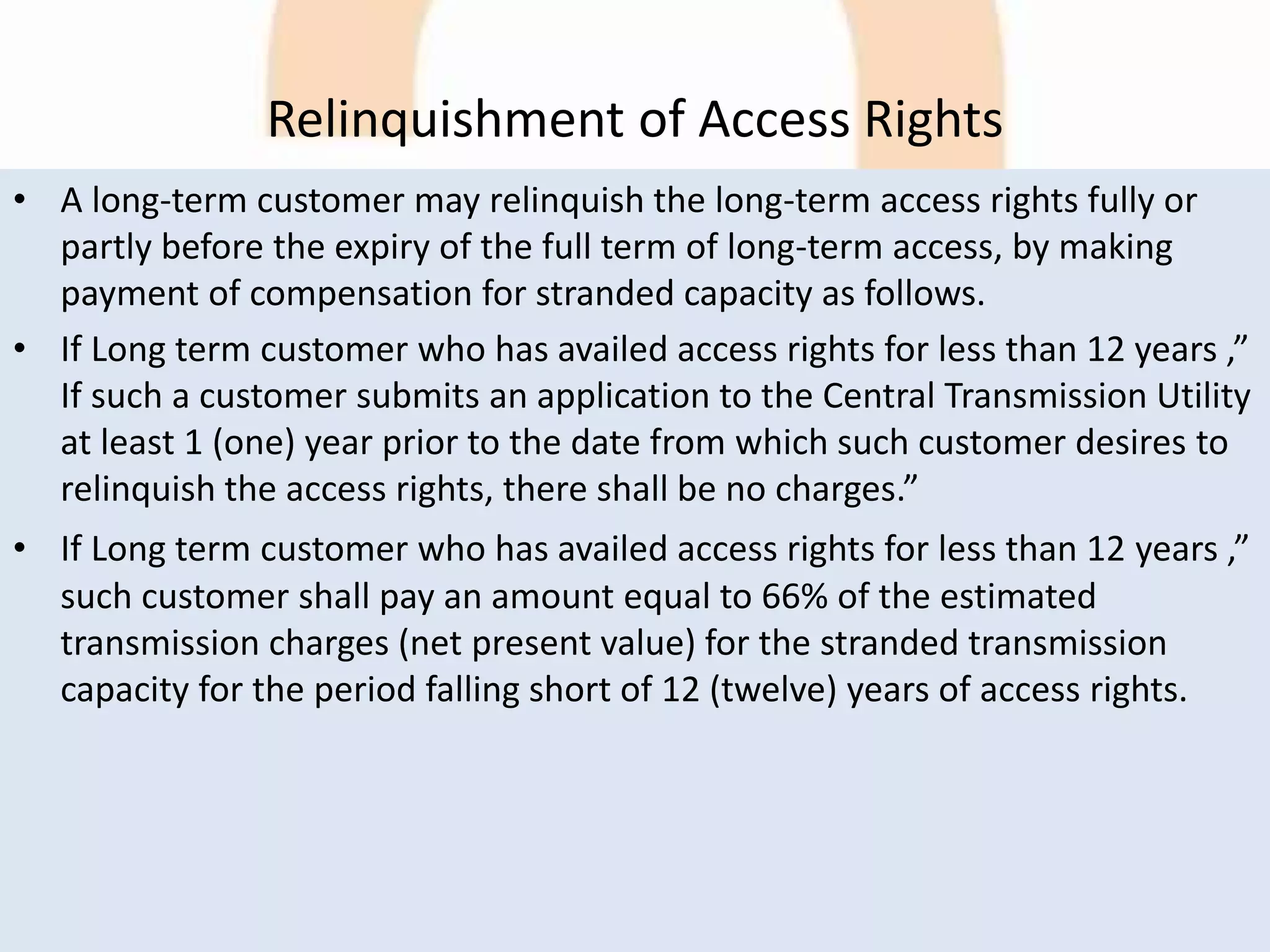

Relinquishment of Access Rights
• A long-term customer may relinquish the long-term access rights fully or
partly before the expiry of the full term of long-term access, by making
payment of compensation for stranded capacity as follows.

• If Long term customer who has availed access rights for less than 12 years ,”
If such a customer submits an application to the Central Transmission Utility
at least 1 (one) year prior to the date from which such customer desires to
relinquish the access rights, there shall be no charges.”
• If Long term customer who has availed access rights for less than 12 years ,”
such customer shall pay an amount equal to 66% of the estimated
transmission charges (net present value) for the stranded transmission
capacity for the period falling short of 12 (twelve) years of access rights.
MEDIUM TERM OPEN ACCESS
System
Studies by
Nodal
Agencies
Application
of Medium-
Term Open
Access
Execution of
Dedicated
Transmission
Line
No
Overriding
Preferences
Grant of
Medium
Term Open
Access
Exit Option
for Medium
Term
Customers
PROCEDURE FOR MAKING APPLICATION
FOR
GRANT OF CONNECTIVITY IN ISTS
Applicant
Nodal Agency, CTU (PGCIL)
INFORMATION REQUIRED TO BE SUBMITTED WITH THE APPLICATION FOR
CONNECTIVITY BY GENERATING STATION
Site identification and land acquisition
Environmental clearance for the power station
Forest Clearance (if applicable) for the land for the power station
Fuel Linkage & Water Linkage
Fee
Payment
Through DD or directly credited to POWERGRID Account electronically
through RTGS
GRANT OF CONNECTIVITY IN ISTS
Contd…
Grant Of
Connectivity
the CTU in consultation and through coordination with State Transmission
Utility, process the application
The intimation shall be communicated to the applicant within 60 days from last
day of the month in which the application has been received
Applicant given intimation for Connectivity to the grid shall have to furnish
additional details to CTU for signing of “Connection Agreement”.
CONSTRUCTION
OF DEDICATED
TRANSMISSION
SYSTEM
a thermal generating station of 500 MW and above and a hydro generating
station of 250 MW and above, other than a captive generating plant, shall not
be required to construct a dedicated line to the point of connection and such
stations shall be taken into account for coordinated transmission planning by
the CTU and CEA.
If dedicated line is to be constructed and terminated by the applicant as per the
Connection Agreement, the modifications at the connection point required to
be under taken by CTU would be undertaken on deposit of estimated cost by
applicant. In this case there shall be no requirement of BG.
GRANT OF CONNECTIVITY IN ISTS
Contd…

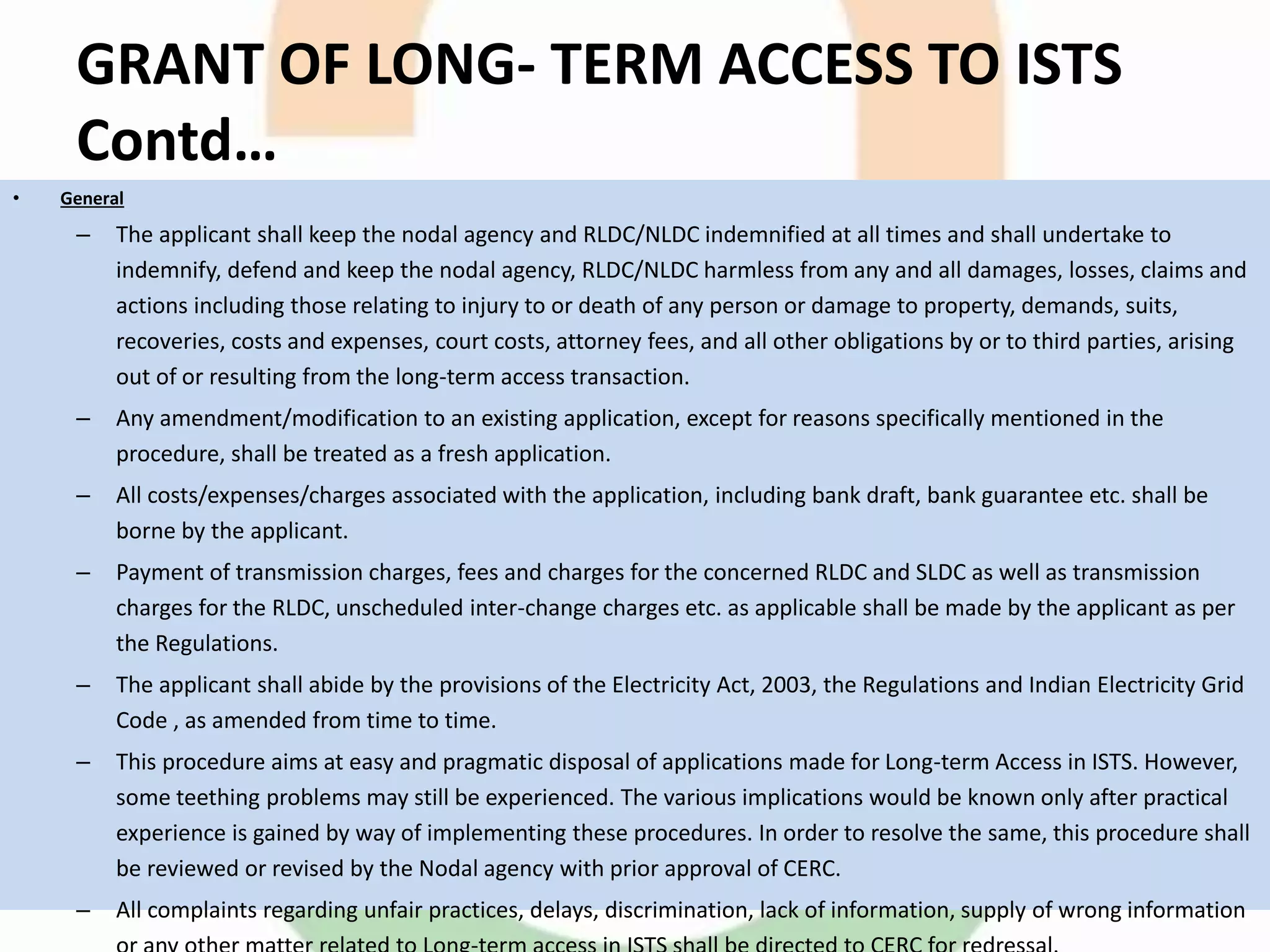

General
Requirements
All costs/expenses/charges associated with the application, including bank
draft, bank guarantee etc. shall be borne by the applicant
All complaints regarding unfair practices, delays, discrimination, lack of
information, supply of wrong information or any other matter related to
grant of connectivity to ISTS shall be directed to CERC for redressal.
The applicant shall abide by the provisions of the Electricity Act, 2003, the
CERC Regulations and Indian Electricity Grid Code , as amended from time
to time.
Preceding
Order of
Application
Application for seeking connection to the inter-State transmission system
Intimation for Grant of Connectivity
Additional information for signing Connection Agreement
Connection Offer Letter
This Agreement

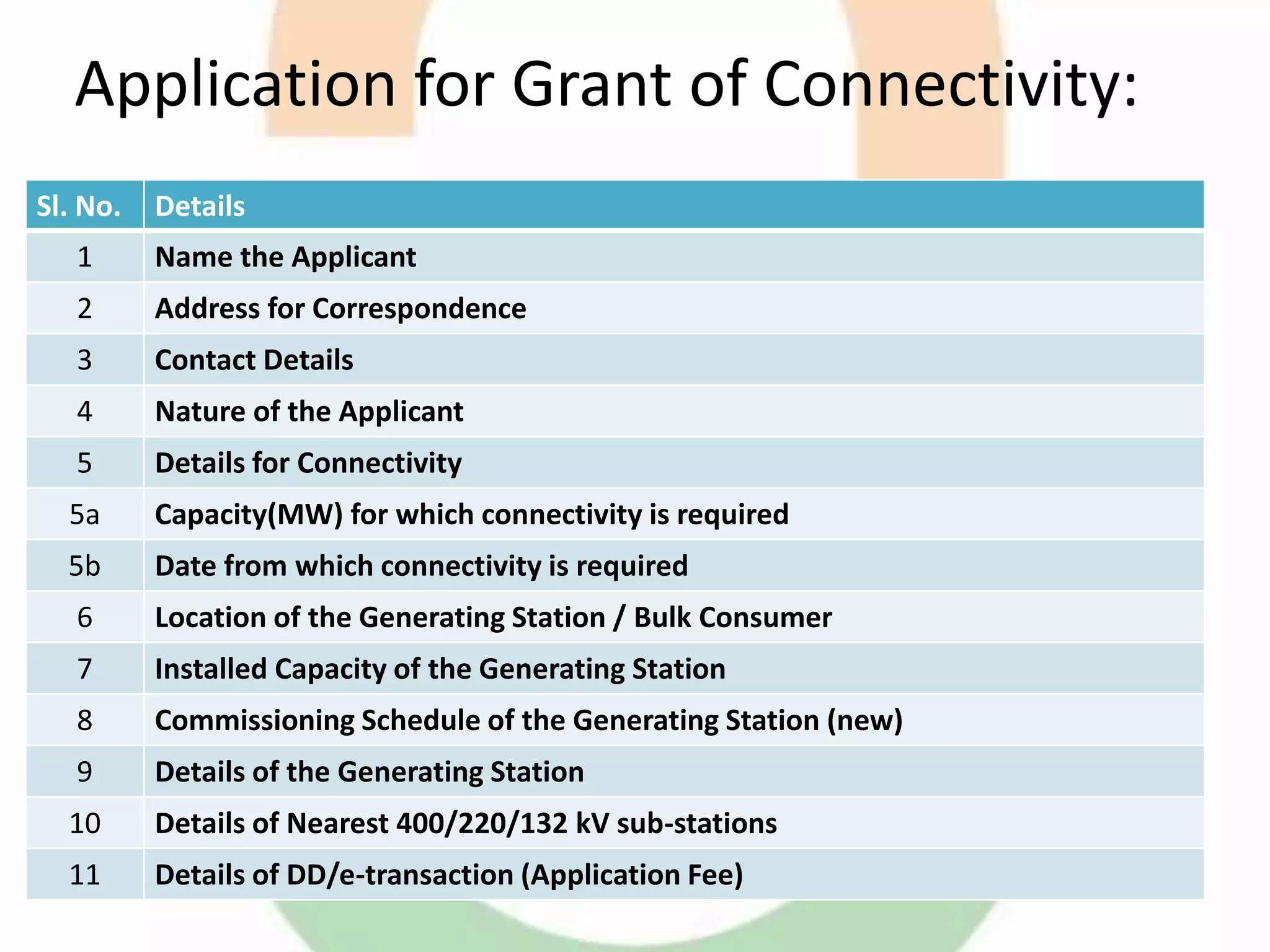

Application for Grant of Connectivity:
Sl. No. Details
1 Name the Applicant
2 Address for Correspondence
3 Contact Details
4 Nature of the Applicant
5 Details for Connectivity
5a Capacity(MW) for which connectivity is required
5b Date from which connectivity is required
6 Location of the Generating Station / Bulk Consumer
7 Installed Capacity of the Generating Station
8 Commissioning Schedule of the Generating Station (new)
9 Details of the Generating Station
10 Details of Nearest 400/220/132 kV sub-stations
11 Details of DD/e-transaction (Application Fee)

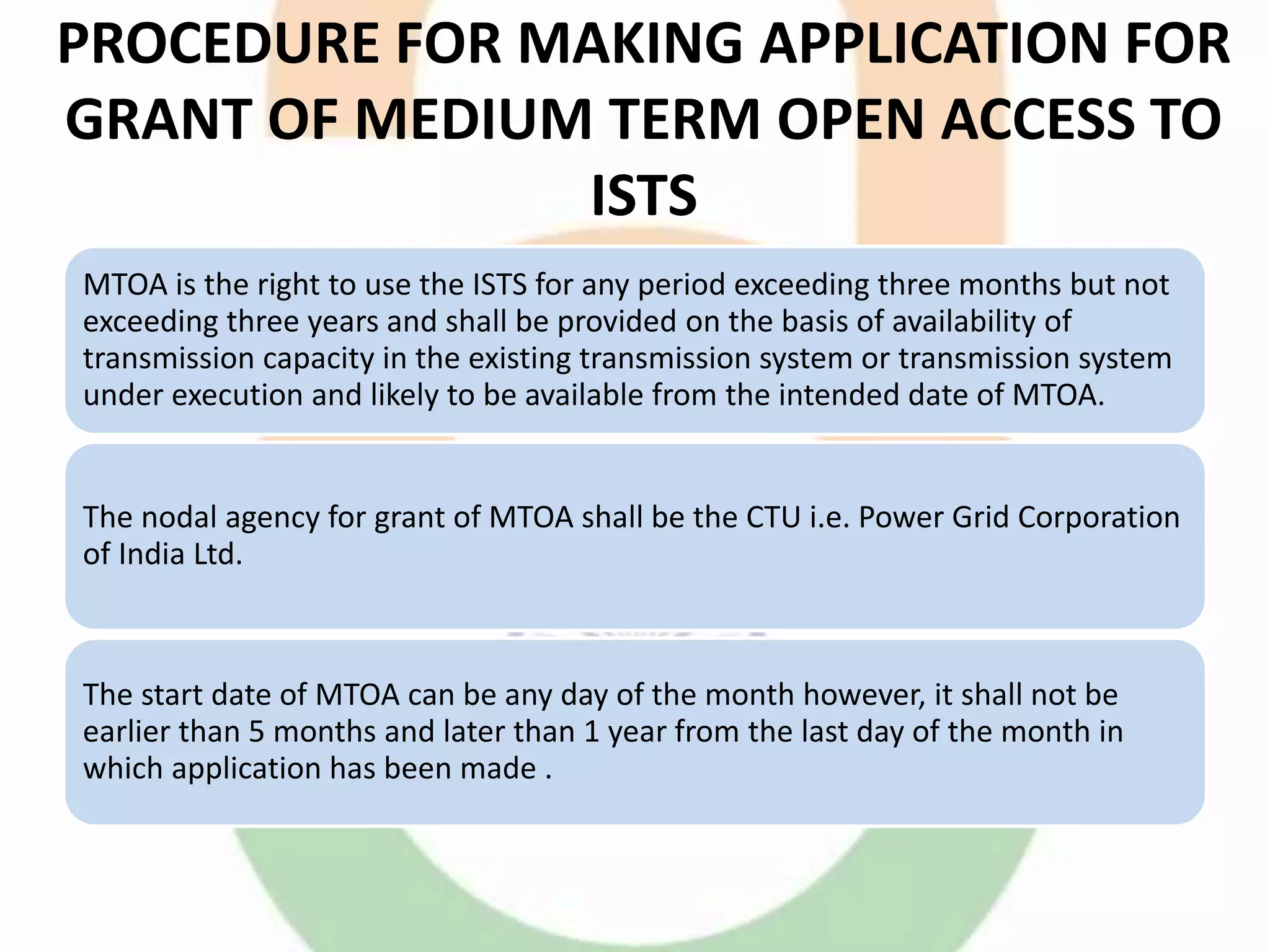

PROCEDURE FOR MAKING APPLICATION FOR
GRANT OF MEDIUM TERM OPEN ACCESS TO
ISTS
MTOA is the right to use the ISTS for any period exceeding three months but not
exceeding three years and shall be provided on the basis of availability of
transmission capacity in the existing transmission system or transmission system
under execution and likely to be available from the intended date of MTOA.
The nodal agency for grant of MTOA shall be the CTU i.e. Power Grid Corporation
of India Ltd.
The start date of MTOA can be any day of the month however, it shall not be
earlier than 5 months and later than 1 year from the last day of the month in
which application has been made .
GRANT OF MEDIUM TERM OPEN ACCESS
TO ISTS Contd…
Applicants for
MTOA
A generating station, including captive generating plant or a bulk consumer, seeking
MTOA to the inter-State transmission system cannot apply for medium-term open
access without applying for connectivity
INFORMATION /
DATA TO BE
FURNISHED
ALONG WITH
THE
APPLICATION
The information in the application shall be supported by a sworn in affidavit by the
applicant
include details like quantum of power to be injected at the suppliers point, details of
injection & drawl points, time period from and up to which access is required, the
source of power, clearance from respective SLDCs for intra state entities etc.
CONCURRENCE
FROM SLDC /
SLDCS
If a State Utility or an intra state entity is applying for MTOA, concurrence of the
concerned State Load Dispatch Centres, both from injection and drawl point SLDCs is
to be submitted along with the application
In case SLDC decides not to give concurrence, the same shall be communicated to the
applicant in writing, giving the reason for refusal within 10 (ten) working days of
receipt of the application..
GRANT OF MEDIUM TERM OPEN ACCESS
TO ISTS Contd…
Application
fee

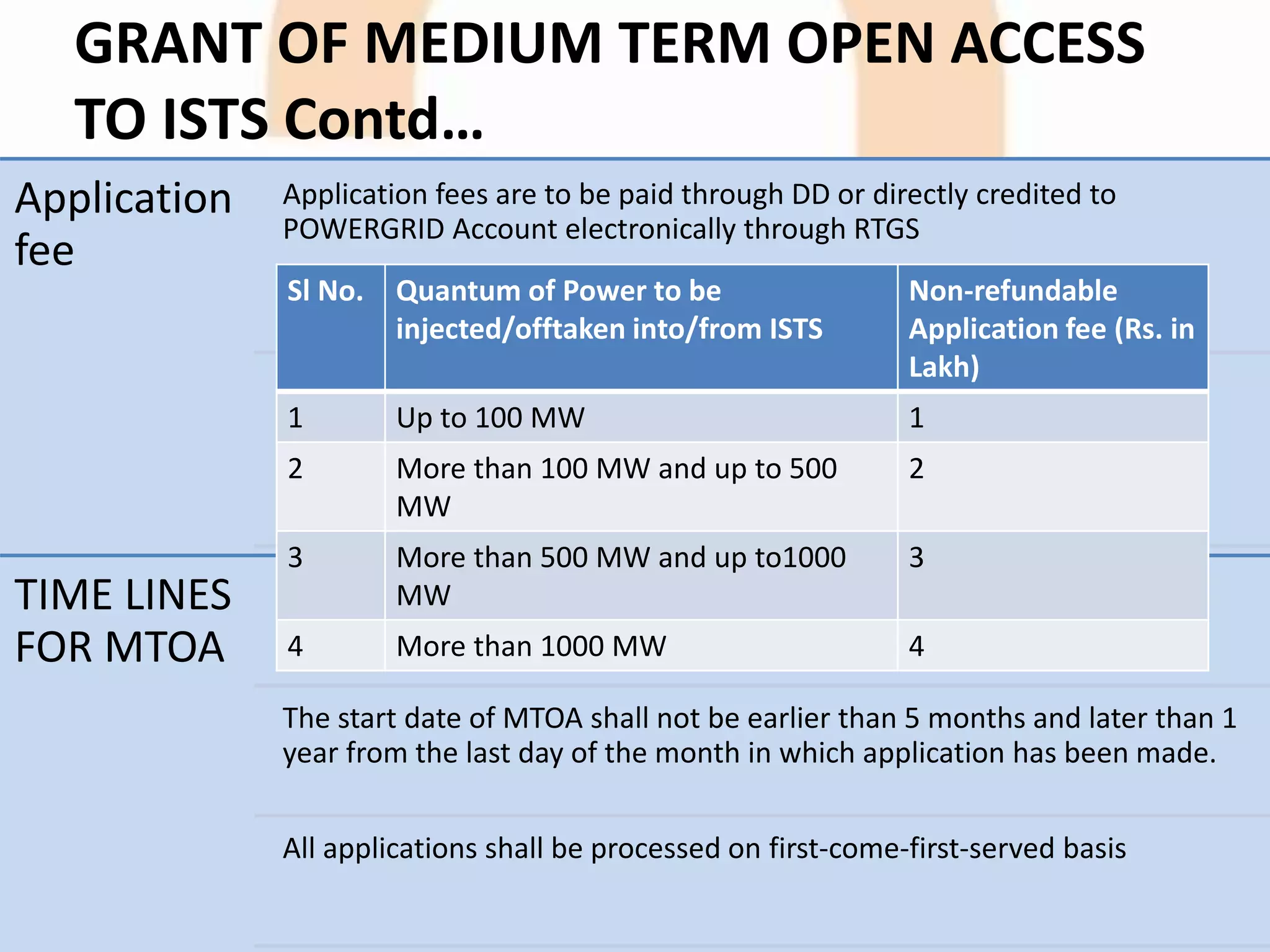

Application fees are to be paid through DD or directly credited to
POWERGRID Account electronically through RTGS
TIME LINES
FOR MTOA
The start date of MTOA shall not be earlier than 5 months and later than 1
year from the last day of the month in which application has been made.
All applications shall be processed on first-come-first-served basis
Sl No. Quantum of Power to be
injected/offtaken into/from ISTS
Non-refundable
Application fee (Rs. in
Lakh)
1 Up to 100 MW 1
2 More than 100 MW and up to 500
MW
2
3 More than 500 MW and up to1000
MW
3
4 More than 1000 MW 4
GRANT OF MEDIUM TERM OPEN ACCESS
TO ISTS Contd…

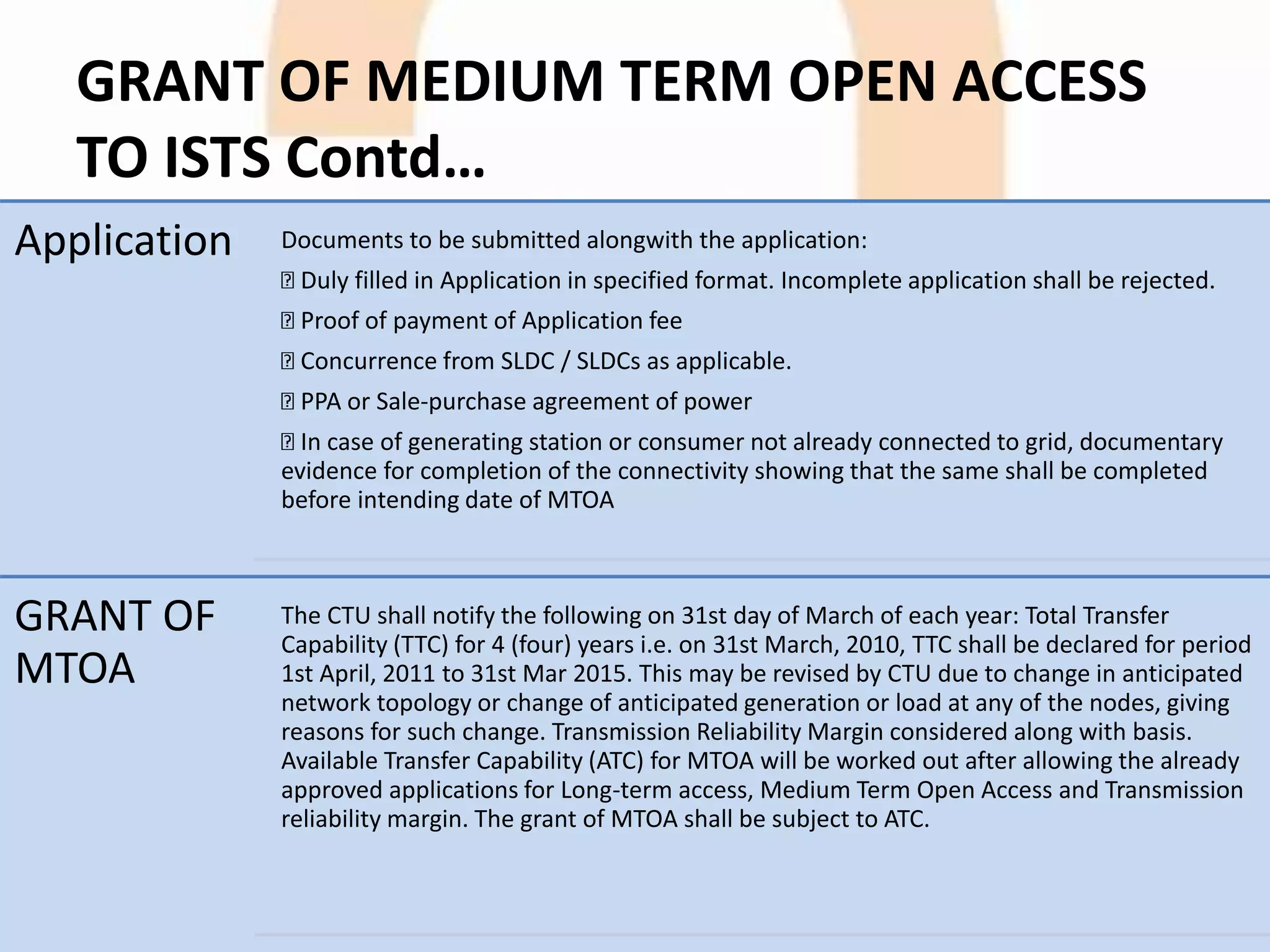

Application Documents to be submitted alongwith the application:
Duly filled in Application in specified format. Incomplete application shall be rejected.
Proof of payment of Application fee
Concurrence from SLDC / SLDCs as applicable.
PPA or Sale-purchase agreement of power
In case of generating station or consumer not already connected to grid, documentary
evidence for completion of the connectivity showing that the same shall be completed
before intending date of MTOA
GRANT OF
MTOA
The CTU shall notify the following on 31st day of March of each year: Total Transfer
Capability (TTC) for 4 (four) years i.e. on 31st March, 2010, TTC shall be declared for period
1st April, 2011 to 31st Mar 2015. This may be revised by CTU due to change in anticipated
network topology or change of anticipated generation or load at any of the nodes, giving
reasons for such change. Transmission Reliability Margin considered along with basis.
Available Transfer Capability (ATC) for MTOA will be worked out after allowing the already
approved applications for Long-term access, Medium Term Open Access and Transmission
reliability margin. The grant of MTOA shall be subject to ATC.
GRANT OF MEDIUM TERM OPEN ACCESS
TO ISTS Contd…

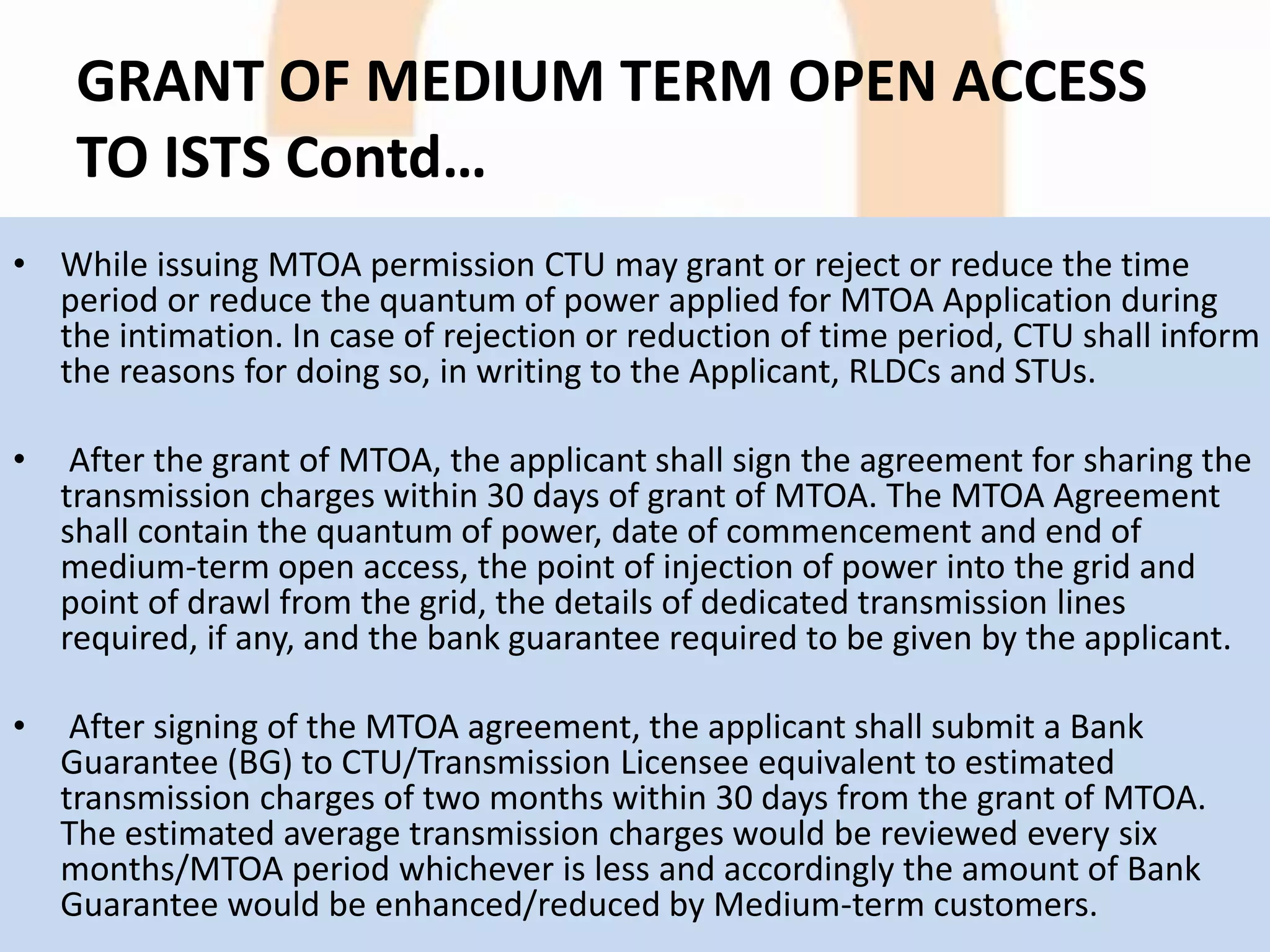

• While issuing MTOA permission CTU may grant or reject or reduce the time
period or reduce the quantum of power applied for MTOA Application during
the intimation. In case of rejection or reduction of time period, CTU shall inform
the reasons for doing so, in writing to the Applicant, RLDCs and STUs.
• After the grant of MTOA, the applicant shall sign the agreement for sharing the
transmission charges within 30 days of grant of MTOA. The MTOA Agreement
shall contain the quantum of power, date of commencement and end of
medium-term open access, the point of injection of power into the grid and
point of drawl from the grid, the details of dedicated transmission lines
required, if any, and the bank guarantee required to be given by the applicant.
• After signing of the MTOA agreement, the applicant shall submit a Bank
Guarantee (BG) to CTU/Transmission Licensee equivalent to estimated
transmission charges of two months within 30 days from the grant of MTOA.
The estimated average transmission charges would be reviewed every six
months/MTOA period whichever is less and accordingly the amount of Bank
Guarantee would be enhanced/reduced by Medium-term customers.
GRANT OF MEDIUM TERM OPEN ACCESS
TO ISTS Contd…
• The agreement for MTOA is to be signed by the applicant with the Central Transmission
Utility in case medium-term open access is granted by the Central Transmission Utility. While
seeking medium-term open access to an inter-State transmission licensee, other than the
Central Transmission Utility, the applicant shall sign a tripartite MTOA agreement with the
Central Transmission Utility and the inter-State transmission licensee.
• In case the MTOA agreement has not been signed or requisite bank guarantee has not been
submitted by the applicant within the stipulated period, the grant of MTOA shall be
cancelled by the CTU and the same shall be informed to Applicant, concerned SLDCs/RLDCs
and STUs.
• Immediately after grant of medium-term open access, the nodal agency shall inform the
RLDCs and SLDCs concerned so that they can consider the same while processing requests
for short- term open access received under Central Electricity Regulatory Commission (Open
Access in inter-State transmission) Regulations, 2008 as amended from time to time.
• g. On the expiry of period of the medium-term open access, the medium-term customer
shall not be entitled to any overriding preference for renewal of the term
GRANT OF MEDIUM TERM OPEN ACCESS
TO ISTS Contd…
• SCHEDULING OF MEDIUM TERM OPEN ACCESS
TRANSACTION
– Underutilization of transmission capacity
• TRANSMISSION CHARGES
• ENCASHMENT / DISCHARGE OF BANK GUARANTEE
• EXIT/ DOWNSIZING
PROCEDURE FOR MAKING APPLICATION
FOR
GRANT OF LONG- TERM ACCESS TO ISTS
• Application for LTA can be made by a Generating station including
a captive generating plant, a consumer, an electricity trader or
distribution licensee, a State Government owning some quantum
of power.
• LTA can be availed for any period between 12 years to 25 years and
might require construction of new transmission capacities.
• in the application for LTA, the applicant shall be required to
indicate location of the load point on the grid of the entity or
entities to whom electricity is proposed to be supplied and the
location of the source point on the grid of the entity from whom
electricity is proposed to be sourced, along with the quantum of
power to be transferred
GRANT OF LONG- TERM ACCESS TO
ISTS Contd…

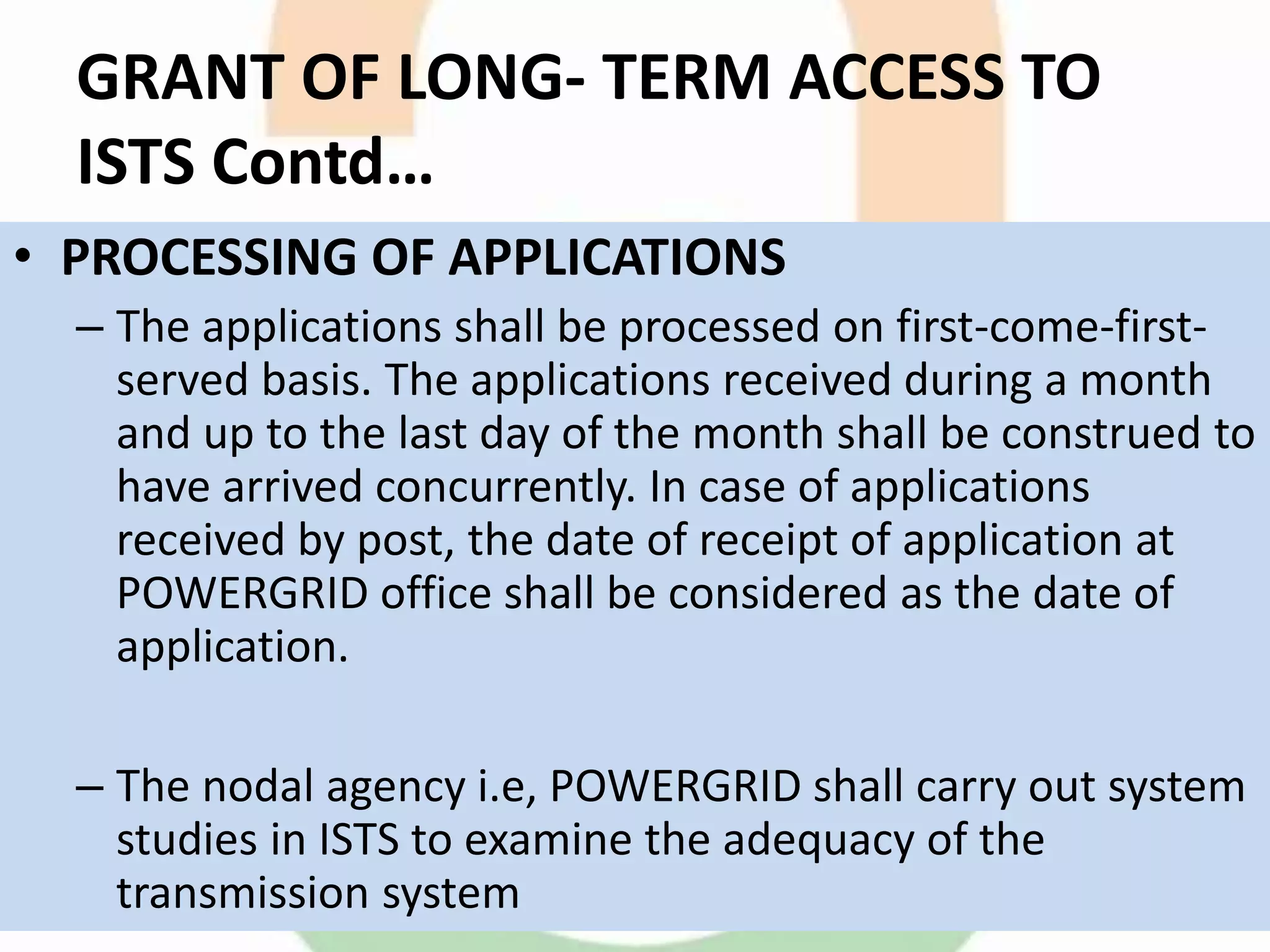

• PROCESSING OF APPLICATIONS
– The applications shall be processed on first-come-first-
served basis. The applications received during a month
and up to the last day of the month shall be construed to
have arrived concurrently. In case of applications
received by post, the date of receipt of application at
POWERGRID office shall be considered as the date of
application.
– The nodal agency i.e, POWERGRID shall carry out system
studies in ISTS to examine the adequacy of the
transmission system
GRANT OF LONG- TERM ACCESS TO
ISTS Contd…

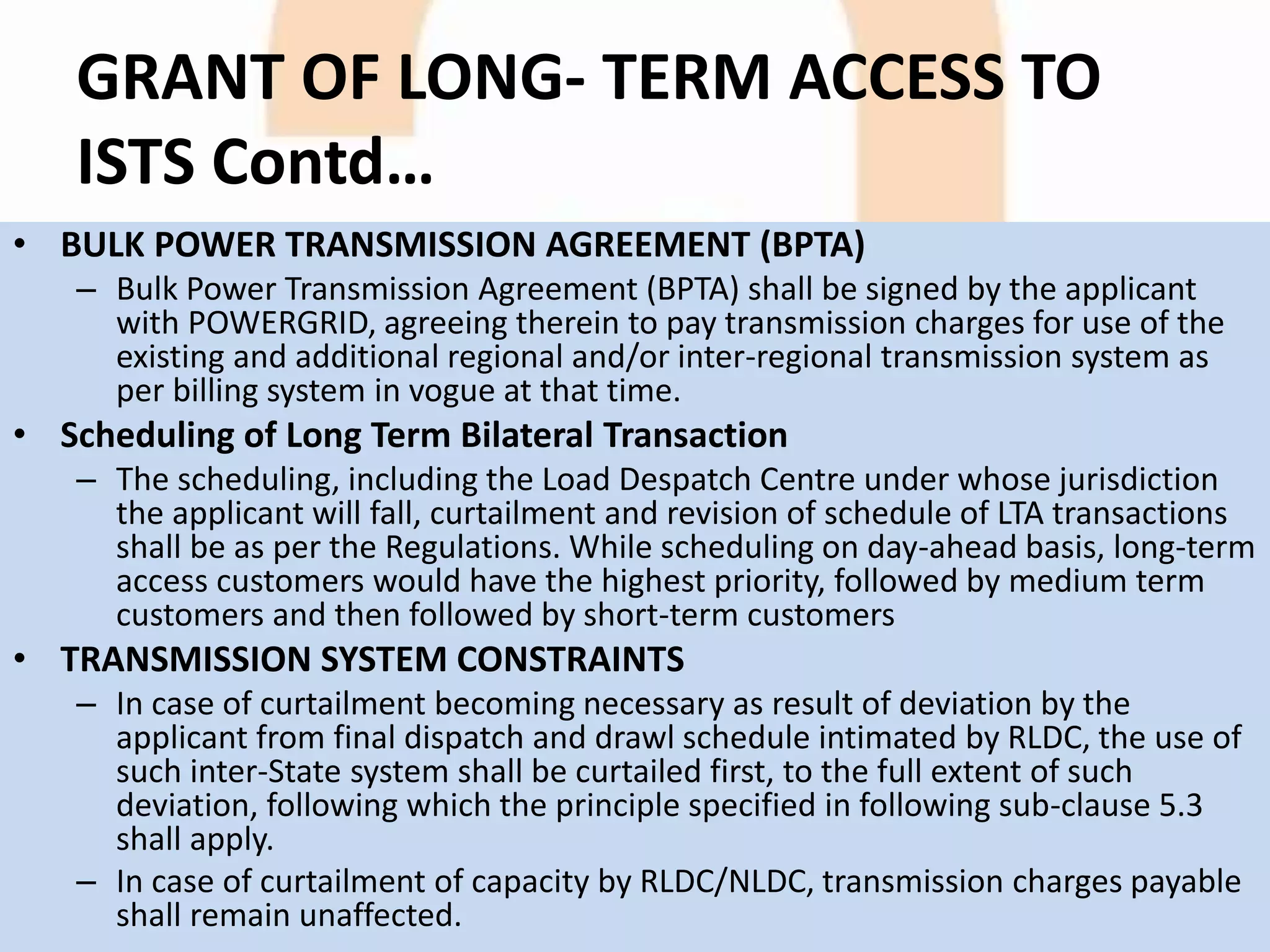

• BULK POWER TRANSMISSION AGREEMENT (BPTA)
– Bulk Power Transmission Agreement (BPTA) shall be signed by the applicant
with POWERGRID, agreeing therein to pay transmission charges for use of the
existing and additional regional and/or inter-regional transmission system as
per billing system in vogue at that time.
• Scheduling of Long Term Bilateral Transaction
– The scheduling, including the Load Despatch Centre under whose jurisdiction
the applicant will fall, curtailment and revision of schedule of LTA transactions
shall be as per the Regulations. While scheduling on day-ahead basis, long-term
access customers would have the highest priority, followed by medium term
customers and then followed by short-term customers
• TRANSMISSION SYSTEM CONSTRAINTS
– In case of curtailment becoming necessary as result of deviation by the
applicant from final dispatch and drawl schedule intimated by RLDC, the use of
such inter-State system shall be curtailed first, to the full extent of such
deviation, following which the principle specified in following sub-clause 5.3
shall apply.
– In case of curtailment of capacity by RLDC/NLDC, transmission charges payable
shall remain unaffected.
GRANT OF LONG- TERM ACCESS TO
ISTS Contd…
• Renewal of Term for Long-term access
On the expiry of the period of long-term access, the long-term access shall stand extended on a written
request provided by the long-term customer in this regard to the Central Transmission Utility
mentioning the period for extension that is required.
Further, such a written request shall be submitted by the long term customer to the Central
Transmission Utility at least six months prior to the date of expiry of the long-term access. In case no
written request is received from the long-term customer within the timeline specified above, the said
long-term access shall stand withdrawn.
• Relinquishment of access rights
A long-term customer may relinquish the long-term access rights fully or partly before the expiry of the
full term of long-term access, by making payment of compensation for stranded capacity as follows:-
1. Long-term customer who has availed access rights for at least 12 years
(i) Notice of one (1) year – If such a customer submits an application to the CTU at least 1 (one) year prior to
the date from which such customer desires to relinquish the access rights, there shall be no charges.
(ii) Notice of less than one (1) year – If such a customer submits an application to the CTU at any time lesser
than a period of 1 (one) year prior to the date from which such customer desires to relinquish the access
rights, such customer shall pay an amount equal to 66% of the estimated transmission charges (net present
value) for the stranded transmission capacity for the period falling short of a notice period of one (1) year.
GRANT OF LONG- TERM ACCESS TO
ISTS Contd…
• Long-term customer who has not availed access rights for at least 12 (twelve) years – such
customer shall pay an amount equal to 66% of the estimated transmission charges (net present
value) for the stranded transmission capacity for the period falling short of 12 (twelve) years of
access rights. Such a customer shall submit an application to the CTU at least 1 (one) year prior to
the date from which such customer desires to relinquish the access rights. In case a customer
submits an application for relinquishment of long-term access rights at any time at a notice period
of less than one year, then such customer shall pay an amount equal to 66% of the estimated
transmission charges (net present value) for the period falling short of a notice period of one (1)
year, in addition to 66% of the estimated transmission charges (net present value) for the stranded
transmission capacity for the period falling short of 12 (twelve) years of access rights.
• The discount rate that shall be applicable for computing the net present value as referred to above
shall be the discount rate to be used for bid evaluation in the Commission‟s Notification issued
from time to time in accordance with the Guidelines for Determination of Tariff by Bidding Process
for Procurement of Power by Distribution Licensees issued by the Ministry of Power.
• The compensation paid by the long-term customer for the stranded transmission capacity shall be
used for reducing transmission charges payable by other long-term customers and medium-term
customers in the year in which such compensation payment is due in the ratio of transmission
charges payable for that year by such long-term customers and medium-term customers.
GRANT OF LONG- TERM ACCESS TO ISTS
Contd…
• General
– The applicant shall keep the nodal agency and RLDC/NLDC indemnified at all times and shall undertake to
indemnify, defend and keep the nodal agency, RLDC/NLDC harmless from any and all damages, losses, claims and
actions including those relating to injury to or death of any person or damage to property, demands, suits,
recoveries, costs and expenses, court costs, attorney fees, and all other obligations by or to third parties, arising
out of or resulting from the long-term access transaction.
– Any amendment/modification to an existing application, except for reasons specifically mentioned in the
procedure, shall be treated as a fresh application.
– All costs/expenses/charges associated with the application, including bank draft, bank guarantee etc. shall be
borne by the applicant.
– Payment of transmission charges, fees and charges for the concerned RLDC and SLDC as well as transmission
charges for the RLDC, unscheduled inter-change charges etc. as applicable shall be made by the applicant as per
the Regulations.
– The applicant shall abide by the provisions of the Electricity Act, 2003, the Regulations and Indian Electricity Grid
Code , as amended from time to time.
– This procedure aims at easy and pragmatic disposal of applications made for Long-term Access in ISTS. However,
some teething problems may still be experienced. The various implications would be known only after practical
experience is gained by way of implementing these procedures. In order to resolve the same, this procedure shall
be reviewed or revised by the Nodal agency with prior approval of CERC.
– All complaints regarding unfair practices, delays, discrimination, lack of information, supply of wrong information
REFERENCES
• http://indianpowersector.com/home/open-access/oa-charges/#
• http://indianpowersector.com/home/tag/atc-losses/
• http://www.iepa.com/wheeling.asp
• http://www.iexindia.com/
• http://reconnectenergy.com/blog/2015/03/uperc-final-solar-rooftop-regulation-
2015/
• http://www.cercind.gov.in/
• http://www.powerexindia.com/
H
O
N

OPEN ACCESS REGULATION

  • 1.
    OPEN ACCESS REGULATION & GRANTOF CONNECTIVITY REGULATION Power that any one can access . . . PRESENTATORS:  Leela Krishna Vegi  Sushovan Bej  Sachin Verma  Sonu kumar  Manish Kumar Gupta  Kartikey Tripathi OPEN
  • 2.
    CONTENT TO DISCUSS •OPEN ACCESS Definition • What the concept was developed? • Objectives of open access • Working process of open access • Structure of open access • Types of open access • Open access according to Electricity Act 2003 • OPEN ACCESS REGULATIONS 2004 | 2006 | 2008 | 2013 | 2014 | • 2013 and 2014 Amendments of Open Access
  • 3.
    OPEN ACCESS DEFINATION “Thenon-discriminatory provision for the use of transmission lines or distribution system or associated facilities with such lines or system by any licensee or consumer or a person engaged in generation in accordance with the regulations specified by the Appropriate Commission” According to Electricity Act 2003
  • 4.
    How the conceptwas developed? According to the Electricity Act 1910 and 1948 the under the section 27 of 1910 and under sub-section 43A (1)(C) of 1948 the open access concept was developed.
  • 5.
    OBJECTIVES OF OPENACCESS To increase competitors in the sector Reduction in AT&C losses Providing quality power supply to the consumers. Substantial improvement in quality of supply Self sustaining sector to attract investments in all areas
  • 6.
    WORKING PROCESS OFOPEN ACCESS WHOLE SALE MARKET GENENERATING COMPANIES UTILITIES CAPATIVE POWER GENERATION TRANSMISSION NEWTWORK [IMMEDIATE OPEN ACCESS] DISTRIBUTION LICENSEE DISTRIBUTION COMPANIES [DISCOMS] LICENSEE AREAS CONSUMERS DISTRIBUTION NETWORK BULK CONSUMERS [Industries] DOMESTIC CONSUMERS [Supply to houses ] This results to COMPETATIVE | FLEXIABILE STRUCTURE | ENABLING CHOICE TO CONSUMER GENERATION NETWORK TRADERS PTC IEX PXIL
  • 7.
    OPEN ACCESS INTER STATE OPENACCESS INTRA STATE OPEN ACCESS SHORT TERM OPEN ACCESS MEDIUM TERM OPEN ACCESS LONG TERM OPEN ACCESS 0 - 3 MONTHS 3 MONTHS - 3 YEARS 12 – 25 YEARS STRUCTURE OF OPEN ACCESS
  • 8.
    Inter-State Transmission Open Access •When buying and selling entity belongs to different states. • In this case CERC regulations are followed. • It is further categorized as: 1. Short Term Open Access (STOA): open access allowed for the period of less than one month. 2. Medium Term Open Access (MTOA): open access allowed for a period of 3 months to 3 years. 3. Long Term Open Access (LTOA): open access allowed for a period of 12 years to 25 years.
  • 9.
    Intra-State Transmission Open Access When buying and selling entity belongs to same state.  In this case SERC regulations are followed.  It is further categorized as STOA, MTOA, and LTOA and the duration of which depends on the respective state open access regulations
  • 10.
    OPEN ACCESS ACCORDINGTO ELECTRICITY ACT 2003 Captive generating plants [operate and maintain] have right to open access for the purpose of carrying electricity from CPP to destination. 1. This subjected to availability of adequate transmission facility which is determined by STU and CTU. 2. If further disputes regarding the availability of transmission shall be adjudicated upon by appropriate commission. TRANSMISSION IN OPEN ACCESS Simple accessibility of transmission lines through open access to generating companies or License.
  • 11.
    CONT . .. • Under section 42 -> By state commission under sub section[2] of section 42 on the payment of transmission charges and surcharges. -> determining the wheeling charges and surcharges. -> Agreement w.r.t supply or purchase of electricity. -> SURCHARGES – these shall not leviable in case of OA is provided to a person who has established a CPP for carrying electricity to destination of his own. DISTRIBUTION LICENSE • Introducing OA in phases and subject to condition [cross subsidies | operational constraints within a year] • Specifying the extent of open access in successive phases and determining the wheeling charges
  • 12.
    Sections governing Open Access as per EA-2003 •Captive Generation Section 9(2) • Functions of CTU Section 38(2)(d) • Functions of STU Section 39(2)(d) • Wheeling Charges Section 42(2) • Additional Surcharge Section 42(4) • Functions of state commission Section 86(1) ( c)
  • 13.
    AUGUST Concept paper on OA inter state transmission SEPTEMBER 2003 Public hearing Onissued paper by CERC JANUARY Issued final order & regulation of OA by CERC MARCH Compliances with respective regulation issued by CTU FEBRAURY Open Access regulation is notified on 06/02/2004 2004 2005 2008 MAY Regulation implementati on took place on 6th may by CERC DECEMBER Issued staff paper or technical document to govt officials to amendments to OA regulation FEBRUARY first amendment of regulation was ordered by CERC APRIL On 1st April 2005 new regulation was implemented MARCH Open Access regulation is notified on 06/02/2004 TIME LINE OF THE OPEN ACCESS EVENT JANUARY OA inter state transmission regulation issued by CERC --------------- CTU issued procedure for scheduling OA [bi-lateral] transaction APRIL On 1st April 2008 Regulation was implemented
  • 14.
    2013 These regulations maybe called the Central Electricity Regulatory Commission (Open Access in inter-State Transmission) (Second Amendment) Regulations, 2013. Grant of Connectivity, Long-term Access and Medium-term Open Access in inter-State Transmission and related matters 2009 In 2009 <1 MW power supply through open access is being introduced into the regulation.
  • 15.
    Processing of Application ForShort-Term Customers • Nodal RLDC to interact with concerned RLDCs/SLDCs to process the same in specified time period. • Processing time as per CERC Order • Up-to One Day : 12 Hours • Up-to One Week : 2 days • Up-to One month : 7 days • Up-to One year : 30 days • Applicant to furnish details of transactions like point of injection/drawal, quantum (MW), duration, along- with necessary payments.
  • 16.
    Approval Process Short-term openaccess to be allowed by utilizing : (a) Inherent design margins, (b) Margins available due to variation in power flows, and (c) Margins available due to in-built spare transmission capacity created to cater to future load growth.” In case of congestion snap bids are to be invited by RLDC. • In case of transmission constraints, the short-term customers shall be curtailed prior to the long term customers. • Provided within a category, the open access customers shall have equal priority and will be curtailed on pro-rata basis.
  • 17.
  • 18.
     These regulationsmay be called the Central Electricity Regulatory Commission (Open Access in inter-State Transmission) Regulations, 2008.  These regulations shall apply to the applications made for grant of open access for energy transfer schedules commencing on or after 1.4.2008 for use of the transmission lines or associated facilities with such lines on the inter State transmission system. Open Access Regulations (2008)
  • 19.
    Scope  The long-termcustomer shall have first priority for using the inter-State transmission system for the designated use. These regulations shall apply for utilization of surplus capacity available thereafter on the inter-State transmission system.  The short-term customer shall be eligible for short-term open access over the surplus capacity available on the inter-State transmission system after use by the long-term customer and the medium-term customer, by virtue of-  Inherent design margins  Margins available due to variation in power flows  Margins available due to in-built spare transmission capacity created to cater to future load growth or generation addition
  • 20.
    Nodal Agency The nodalagency for bilateral transactions shall be the State Load Despatch Centre of the region where point of drawal of electricity is situated and in case of the collective transactions, the nodal agency shall be the National Load Despatch Centre. TYPES Of TRANSACTIONS  “Bilateral transaction” means a transaction for exchange of energy (MWh) between a specified buyer and a specified seller, directly or through a trading licensee, from a specified point of injection to a specified point of drawal for a fixed or varying quantum of power (MW) for any time period during a month.  “Collective transaction” means a set of transactions discovered in power exchange through anonymous, simultaneous competitive bidding by buyers and sellers TYPES OF TRANSACTIONS BI-LATERAL TRANSACTION COLLECTIVE TRANSACTION
  • 21.
    Type of TransactionTransmission charges (Total) (Rs./MWh) Bilateral, intra-regional 30 Bilateral, between adjacent regions 60 Bilateral, wheeling through one or more intervening regions 90 Transmission Charges ( Long-term and medium-term OA) :  In case of bilateral transactions, for use of the inter-State transmission system, the transmission charges at the rate specified :  In case of the collective transaction, for use of the inter-State transmission system, transmission charges at the rate of Rs.30/MWh for energy approved for transmission for each point of injection and for each point of drawal shall be payable.
  • 22.
    Type of TransactionTransmission charges (Total) (Rs./MWh) Bilateral, intra-regional 80 Bilateral, between adjacent regions 160 Bilateral, wheeling through one or more intervening regions 240 Transmission Charges ( Short-term OA) :  In case of bilateral transactions, for use of the short term inter-State transmission system, the transmission charges at the rate specified :  In case of the collective transaction, for use of the inter-State transmission system, transmission charges at the rate of Rs.100/MWh for energy approved for transmission for each point of injection and for each point of drawal shall be payable.
  • 23.
    Operating Charges Reactive EnergyCharges No separate reactive energy charge accounting for open access transactions shall be carried out at inter-State level: Provided that the State Utility designated for the purpose shall be responsible for timely payment of the State’s composite dues to the regional reactive charge account in accordance with the provisions of the Grid Code
  • 24.
    Unscheduled Inter-change (UI)Charges  All transactions for State utilities and for intra-State entities scheduled by the nodal agency under these regulations, shall be accounted for and included in the respective day-ahead net interchange schedules of the concerned regional entity issued by the Regional Load Despatch Centre.  Based on net metering on the periphery of each regional entity, composite UI accounts shall be issued for each regional entity on a weekly cycle and transaction-wise UI accounting, and UI accounting for intra-State entities shall not be carried out at the regional level.  Unless specified otherwise by the concerned State Commission, UI rate for intra- State entity shall be 105% (for over-drawals or under generation) and 95% (for under-drawals or over generation) of UI rate at the periphery of regional entity
  • 25.
    Transmission Losses  Thebuyers and sellers of the electricity shall absorb apportioned energy losses in the transmission system as estimated by the Regional Load Despatch Centre and the State Load Despatch Centre concerned  The applicable transmission losses for the regional transmission system as well as for State network shall be declared in advance and shall not be revised over the month. Special Energy Meters To be installed shall be capable of time - differentiated measurements for time block wise active energy and voltage differentiated measurement of reactive energy in accordance with the Grid Code.
  • 26.
    Redressal Mechanism Unless thedispute involves the State Load Despatch Centre and the intra-State entities of the concerned State and falls within the jurisdiction of the State Commission, all disputes arising under these regulations shall be decided by the Commission based on an application made by the person aggrieved.  When so directed by the Commission, the National Load Despatch Centre or the Regional Load Despatch Centre, as the case may be, shall not grant short-term open access to the entities and associates of such entities, who consistently and willfully default in payment of Unscheduled Interchange charges, transmission charges, reactive energy charges, congestion charges and fee and charges for National Load Despatch Centre or Regional Load Despatch Centre including the charges for the Unified Load Despatch and Communication Scheme .
  • 27.
    Submission of Application An open access customer or the power exchange (on behalf of buyers and sellers) intending to avail of short-term open access for use of the transmission lines or associated facilities for such lines on the inter-State transmission system, shall make an application to the nodal agency in accordance with these regulations.  The application for a bilateral transaction shall contain the details, such as names and location of supplier and buyer, contracted power (MW) to be scheduled and interface at which it is referred to, point of injection, point of drawal, starting time block and date, ending time block and date, and such other information that may be required in the detailed procedure.  An Application made for each Bilateral Transaction shall be accompanied by a non-refundable fee as specified in the Regulations. Provided that the fee for Bilateral Transaction on the day of the Application or on the day immediately following the day of the Application may be deposited within three working days of submission of the Application. APPLICATION PROCEDURE
  • 28.
    CONTINUE.. A copy ofthe Application shall be endorsed by the applicant to the following: a) Each RLDC involved in the transaction b) Each SLDC involved in the transaction Application Fee  An application made for each bilateral transaction or the collective transaction shall be accompanied by a non-refundable fee of Rupees five thousand (Rs.5000/- ) only  Provided that the fee for bilateral transaction on the day of the application or on the day immediately following the day of the application may be deposited within three working days of submission of the application.
  • 30.
    GRANT OF OPEN ACCESS FIRST- COME FIRST - SERVE METHOD DAY AHEAD TRANSACTION TRANSACTION IN A CONTIGENCY GRANT OF OPEN ACCESS
  • 31.
    Where in theopinion of the nodal agency, grant of all applications at a particular stage of advance scheduling is likely to cause congestion in one or more of the transmission corridors to be used, it shall conduct electronic bidding for grant of for the available surplus transmission capacity among the applicants at that stage, in accordance with the detailed procedure Provided that if any person does not participate in the bidding process he shall be deemed to have withdrawn his application Congestion Management
  • 32.
    These regulations maybe called the Central Electricity Regulatory Commission (Grant of Connectivity, Long-term Access and Medium-term Open Access in inter-State Transmission and related matters) Regulations, 2009. • The amendments were proposed to be effective from 1.4.2009. • However, It was also felt that the Central Transmission Utility would require some time to amend the existing detailed the Commission decided that the amended regulations shall apply to all the applications for grant of open access received by the nodal agencies on or after 15.6.2009. Open access 2009
  • 33.
    Scope The grant ofconnectivity, long-term access and medium-term open access, in respect of inter-State transmission system:  Provided that a generating station, including captive generating plant or a bulk consumer, seeking connectivity to the inter-State transmission system cannot apply for long-term access or medium term open access without applying for connectivity  Provided further that a person may apply for connectivity and long-term access or medium-term open access simultaneously. Nodal Agency The nodal agency for grant of connectivity, long-term access and medium term open access to the inter-State transmission system shall be the Central Transmission Utility.
  • 34.
    State-wise Open AccessConsumers at IEX (As on 30th June 2013) State Generators Consumers Jammu & Kashmir 3 0 Himachal Pradesh 3 1 Punjab 2 303 Haryana 1 146 Uttarakhand 1 40 Rajasthan 13 121 Madhya Pradesh 10 11 Gujarat 20 225 Maharashtra 10 3 Goa 1 0 Orissa 11 1 Chhattisgarh 10 0 West Bengal 2 0 Arunachal Pradesh 1 4 Meghalaya 3 2 Karnataka 45 26 Andhra Pradesh 22 597 Tamil Nadu 0 499 Kerala 0 8 Others 30 1 Total 178 1988
  • 35.
    State-wise Open AccessConsumers at IEX (As on 30th June 2013) 597 499 303 226 146 121 40 26 11 8 4 3 5 0 100 200 300 400 500 600 700 No.ofOpenAccessConsumers State-wise OA Consumers at IEX Today almost 2000 plus consumers are availing OA through IEX
  • 36.
    Open Access Charges i.Connectivity Charges ii. PoC Charges [Point of Connection] iii. Transmission Charges includes reactive charges iv. Transmission Losses v. Wheeling Charges vi. Wheeling Losses vii. Cross Subsidy Surcharge viii. SLDC Charges ix. RLDC Charges ***In addition to these charges the open access consumers has also to fulfil the renewable purchase obligation (RPO), in which they have to purchase a part of their total consumption through electricity generated from renewable energy. SOURCE: http://indianpowersector.com/home/open-access/oa-charges/#
  • 37.
    PHASES OF OPENACCESS • Open Access in Transmission shall be allowed immediately. • Open Access in Distribution system shall be in Phases. A. Delivering of electricity to >= 5MW load consumers B. Delivering of electricity to >= 3MW load consumers C. Delivering of electricity to >= 1MW load consumers • The commission may allow open access to consumers with capacity requirement less than one MW subject to review of the operational constraints and other factors. (DERC terms and Cond)
  • 38.
    Classification of OpenAccess Customers • Direct Customer – Persons directly connected to system owned or operated by CTU • Embedded Customer – Other than direct customer
  • 39.
    Advantages • Free accessto consumers and trade and freedom to choose • No restrictions on captive generations • Reduced financial and regulatory risks • Non discriminatory open access to transmission lines • Multi buyer model • Private captive investment allowed • No monopoly over consumers • Parallel distribution networks allowed • 100% metering • Wide consumer choice available • Helps develop a robust power market • Mitigates off-take risk for generators • Balance inter-regional disparities in power availability
  • 40.
    Disadvantages • Lack ofadequate support from the state government • Pre-determined stand-by charges for open access consumers • Levying of high cross subsidy charges by SERC’s and uncertainty of phase out the same • Independent functioning and capacity building of SLDC’s
  • 41.
    Opportunities 1. For GeneratingCompanies • No license required for developing a generating station • could sell power to any person through open access • Easy change in purchaser in the event of default in honoring the contract by the purchaser. 2. For consumers • Buy power from anywhere – could explore cheaper sources specially useful for high demand industrial / commercial consumers. • Industrial houses could consolidate power supply to plants at various locations and build captive power plant to achieve economy
  • 42.
  • 43.
    Introduction: Connectivity: • For agenerating station, including a captive generating plant, a bulk consumer or an inter-State transmission licensee means the state of getting connected to the inter-State transmission system. Long Term Access: • Right to use the inter-State transmission system for a period exceeding 12 years but not exceeding 25 years; Medium-term Open Access: • The right to use the inter-State transmission system for a period exceeding 3 months but not exceeding 3 years;
  • 44.
    Applicant: • A personmay apply for connectivity and long-term access or medium-term open access simultaneously. • Applications for grant of connectivity or long-term access or medium-term open access shall be made to the nodal agency (Central Transmission Utility). • Applicant – A Generating station of installed capacity >= 250MW – A Captive Plant of exportable capacity >= 250MW – A Bulk Consumer : minimum of 100 MW load – A Distribution Licensee – An Electricity Trader
  • 45.
    Application Fees: Sly No. Quantum ofPower to be injected/off taken into/from ISTS Application Fees (Rest. In Lakhs) For Connectivity Long-term Access Medium-term Open Access 1 Up to 100 MW 2 2 1 2 More than 100 MW and up to 500 MW 3 3 2 3 More than 500 MW and up to 1000 MW 6 6 3 4 More than 1000 MW 9 9 4
  • 46.
    Timeframe for processingof application: Nature Of Application Time limit for processing beginning the last day of the month in which application was received by the nodal agency Connectivity 60 days Long-term Access 120 days where augmentation of transmission system is not required 180 days where augmentation of transmission system is required Medium-term Open Access 40 days
  • 47.
    Grant of Connectivity •The application for connectivity shall contain details such as, proposed geographical location of the applicant, quantum of power to be interchanged. • The nodal agency shall, in consultation and through coordination with other agencies involved in inter-State transmission system to be used and the substations or switchyard to be used is also to be defined . • The grant of connectivity shall not entitle an applicant to interchange any power with the grid unless it obtains long-term access, medium- term open access or short-term open access. • An applicant may be required by the Central Transmission Utility to construct a dedicated line to the point of connection to enable connectivity to the grid.
  • 48.
    Long Term andMedium Term Open Access • Criteria for open access-Before awarding long-term access, the Central Transmission Utility shall have due regard to the augmentation of inter-State transmission system proposed under the plans made by the Central Electricity Authority. • Medium-term open access shall be granted if the resultant power flow can be accommodated in the existing transmission system or the transmission system under execution. • Provided that no augmentation shall be carried out to the transmission system for the sole purpose of granting medium-term open access.
  • 49.
    Long terms more priority Firstcome first serve Concurrence to be obtained from SLDC for interstate transmission Priority If infrastructure already developed SLDC should covey to applicant Otherwise State entities if STU installs meters Meters should be open for inspections either interstate or intra state Interface meter cost is upon RLDC if CTU installs meters
  • 50.
    Long Term OpenAccess • The application for grant of long-term access shall contain details such as name of the entity or entities to whom electricity is proposed to be supplied or from whom electricity is proposed to be procured along with the quantum of power and such other details as may be laid down by the Central Transmission Utility in the detailed procedure. • Provided also that in cases where there is any material change in location of the applicant or change by more than 100 MW in the quantum of power to be interchanged using the inter-State transmission system or change in the region from which electricity is to be procured or to which supplied, afresh application shall be made. • The application shall be accompanied by a bank guarantee of Rs10,000/- (ten thousand) per MW of the total power to be transmitted. The bank guarantee shall be in favour of the nodal agency, in the manner laid down under the detailed procedure.
  • 51.
    System studies by nodalagencies Communication and estimate of Transmission charges etc. Execution of Long- Term Access Agreement Information to RLDC & SLDC Relinquishment of Access Rights
  • 52.
    Execution of Long-TermAccess Agreement • While seeking long-term access to an inter-State transmission licensee, other than the Central Transmission Utility, the applicant shall sign a tripartite long-term access agreement with the Central Transmission Utility and the inter-State transmission licensee. • The long–term access agreement shall contain the date of commencement of long-term access, the point of injection of power into the grid and point of drawal from the grid and the details of dedicated transmission lines, if any, required. • Incase augmentation of transmission system is required, the long- term access agreement shall contain the time line for construction of the facilities of the applicant and the transmission licensee, the bank guarantee required to be 18 given by the applicant and other details in accordance with the detailed procedure.
  • 53.
    Relinquishment of AccessRights • A long-term customer may relinquish the long-term access rights fully or partly before the expiry of the full term of long-term access, by making payment of compensation for stranded capacity as follows. • If Long term customer who has availed access rights for less than 12 years ,” If such a customer submits an application to the Central Transmission Utility at least 1 (one) year prior to the date from which such customer desires to relinquish the access rights, there shall be no charges.” • If Long term customer who has availed access rights for less than 12 years ,” such customer shall pay an amount equal to 66% of the estimated transmission charges (net present value) for the stranded transmission capacity for the period falling short of 12 (twelve) years of access rights.
  • 54.
    MEDIUM TERM OPENACCESS System Studies by Nodal Agencies Application of Medium- Term Open Access Execution of Dedicated Transmission Line No Overriding Preferences Grant of Medium Term Open Access Exit Option for Medium Term Customers
  • 55.
    PROCEDURE FOR MAKINGAPPLICATION FOR GRANT OF CONNECTIVITY IN ISTS Applicant Nodal Agency, CTU (PGCIL) INFORMATION REQUIRED TO BE SUBMITTED WITH THE APPLICATION FOR CONNECTIVITY BY GENERATING STATION Site identification and land acquisition Environmental clearance for the power station Forest Clearance (if applicable) for the land for the power station Fuel Linkage & Water Linkage Fee Payment Through DD or directly credited to POWERGRID Account electronically through RTGS
  • 56.
    GRANT OF CONNECTIVITYIN ISTS Contd… Grant Of Connectivity the CTU in consultation and through coordination with State Transmission Utility, process the application The intimation shall be communicated to the applicant within 60 days from last day of the month in which the application has been received Applicant given intimation for Connectivity to the grid shall have to furnish additional details to CTU for signing of “Connection Agreement”. CONSTRUCTION OF DEDICATED TRANSMISSION SYSTEM a thermal generating station of 500 MW and above and a hydro generating station of 250 MW and above, other than a captive generating plant, shall not be required to construct a dedicated line to the point of connection and such stations shall be taken into account for coordinated transmission planning by the CTU and CEA. If dedicated line is to be constructed and terminated by the applicant as per the Connection Agreement, the modifications at the connection point required to be under taken by CTU would be undertaken on deposit of estimated cost by applicant. In this case there shall be no requirement of BG.
  • 57.
    GRANT OF CONNECTIVITYIN ISTS Contd… General Requirements All costs/expenses/charges associated with the application, including bank draft, bank guarantee etc. shall be borne by the applicant All complaints regarding unfair practices, delays, discrimination, lack of information, supply of wrong information or any other matter related to grant of connectivity to ISTS shall be directed to CERC for redressal. The applicant shall abide by the provisions of the Electricity Act, 2003, the CERC Regulations and Indian Electricity Grid Code , as amended from time to time. Preceding Order of Application Application for seeking connection to the inter-State transmission system Intimation for Grant of Connectivity Additional information for signing Connection Agreement Connection Offer Letter This Agreement
  • 58.
    Application for Grantof Connectivity: Sl. No. Details 1 Name the Applicant 2 Address for Correspondence 3 Contact Details 4 Nature of the Applicant 5 Details for Connectivity 5a Capacity(MW) for which connectivity is required 5b Date from which connectivity is required 6 Location of the Generating Station / Bulk Consumer 7 Installed Capacity of the Generating Station 8 Commissioning Schedule of the Generating Station (new) 9 Details of the Generating Station 10 Details of Nearest 400/220/132 kV sub-stations 11 Details of DD/e-transaction (Application Fee)
  • 59.
    PROCEDURE FOR MAKINGAPPLICATION FOR GRANT OF MEDIUM TERM OPEN ACCESS TO ISTS MTOA is the right to use the ISTS for any period exceeding three months but not exceeding three years and shall be provided on the basis of availability of transmission capacity in the existing transmission system or transmission system under execution and likely to be available from the intended date of MTOA. The nodal agency for grant of MTOA shall be the CTU i.e. Power Grid Corporation of India Ltd. The start date of MTOA can be any day of the month however, it shall not be earlier than 5 months and later than 1 year from the last day of the month in which application has been made .
  • 60.
    GRANT OF MEDIUMTERM OPEN ACCESS TO ISTS Contd… Applicants for MTOA A generating station, including captive generating plant or a bulk consumer, seeking MTOA to the inter-State transmission system cannot apply for medium-term open access without applying for connectivity INFORMATION / DATA TO BE FURNISHED ALONG WITH THE APPLICATION The information in the application shall be supported by a sworn in affidavit by the applicant include details like quantum of power to be injected at the suppliers point, details of injection & drawl points, time period from and up to which access is required, the source of power, clearance from respective SLDCs for intra state entities etc. CONCURRENCE FROM SLDC / SLDCS If a State Utility or an intra state entity is applying for MTOA, concurrence of the concerned State Load Dispatch Centres, both from injection and drawl point SLDCs is to be submitted along with the application In case SLDC decides not to give concurrence, the same shall be communicated to the applicant in writing, giving the reason for refusal within 10 (ten) working days of receipt of the application..
  • 61.
    GRANT OF MEDIUMTERM OPEN ACCESS TO ISTS Contd… Application fee Application fees are to be paid through DD or directly credited to POWERGRID Account electronically through RTGS TIME LINES FOR MTOA The start date of MTOA shall not be earlier than 5 months and later than 1 year from the last day of the month in which application has been made. All applications shall be processed on first-come-first-served basis Sl No. Quantum of Power to be injected/offtaken into/from ISTS Non-refundable Application fee (Rs. in Lakh) 1 Up to 100 MW 1 2 More than 100 MW and up to 500 MW 2 3 More than 500 MW and up to1000 MW 3 4 More than 1000 MW 4
  • 62.
    GRANT OF MEDIUMTERM OPEN ACCESS TO ISTS Contd… Application Documents to be submitted alongwith the application: Duly filled in Application in specified format. Incomplete application shall be rejected. Proof of payment of Application fee Concurrence from SLDC / SLDCs as applicable. PPA or Sale-purchase agreement of power In case of generating station or consumer not already connected to grid, documentary evidence for completion of the connectivity showing that the same shall be completed before intending date of MTOA GRANT OF MTOA The CTU shall notify the following on 31st day of March of each year: Total Transfer Capability (TTC) for 4 (four) years i.e. on 31st March, 2010, TTC shall be declared for period 1st April, 2011 to 31st Mar 2015. This may be revised by CTU due to change in anticipated network topology or change of anticipated generation or load at any of the nodes, giving reasons for such change. Transmission Reliability Margin considered along with basis. Available Transfer Capability (ATC) for MTOA will be worked out after allowing the already approved applications for Long-term access, Medium Term Open Access and Transmission reliability margin. The grant of MTOA shall be subject to ATC.
  • 63.
    GRANT OF MEDIUMTERM OPEN ACCESS TO ISTS Contd… • While issuing MTOA permission CTU may grant or reject or reduce the time period or reduce the quantum of power applied for MTOA Application during the intimation. In case of rejection or reduction of time period, CTU shall inform the reasons for doing so, in writing to the Applicant, RLDCs and STUs. • After the grant of MTOA, the applicant shall sign the agreement for sharing the transmission charges within 30 days of grant of MTOA. The MTOA Agreement shall contain the quantum of power, date of commencement and end of medium-term open access, the point of injection of power into the grid and point of drawl from the grid, the details of dedicated transmission lines required, if any, and the bank guarantee required to be given by the applicant. • After signing of the MTOA agreement, the applicant shall submit a Bank Guarantee (BG) to CTU/Transmission Licensee equivalent to estimated transmission charges of two months within 30 days from the grant of MTOA. The estimated average transmission charges would be reviewed every six months/MTOA period whichever is less and accordingly the amount of Bank Guarantee would be enhanced/reduced by Medium-term customers.
  • 64.
    GRANT OF MEDIUMTERM OPEN ACCESS TO ISTS Contd… • The agreement for MTOA is to be signed by the applicant with the Central Transmission Utility in case medium-term open access is granted by the Central Transmission Utility. While seeking medium-term open access to an inter-State transmission licensee, other than the Central Transmission Utility, the applicant shall sign a tripartite MTOA agreement with the Central Transmission Utility and the inter-State transmission licensee. • In case the MTOA agreement has not been signed or requisite bank guarantee has not been submitted by the applicant within the stipulated period, the grant of MTOA shall be cancelled by the CTU and the same shall be informed to Applicant, concerned SLDCs/RLDCs and STUs. • Immediately after grant of medium-term open access, the nodal agency shall inform the RLDCs and SLDCs concerned so that they can consider the same while processing requests for short- term open access received under Central Electricity Regulatory Commission (Open Access in inter-State transmission) Regulations, 2008 as amended from time to time. • g. On the expiry of period of the medium-term open access, the medium-term customer shall not be entitled to any overriding preference for renewal of the term
  • 65.
    GRANT OF MEDIUMTERM OPEN ACCESS TO ISTS Contd… • SCHEDULING OF MEDIUM TERM OPEN ACCESS TRANSACTION – Underutilization of transmission capacity • TRANSMISSION CHARGES • ENCASHMENT / DISCHARGE OF BANK GUARANTEE • EXIT/ DOWNSIZING
  • 66.
    PROCEDURE FOR MAKINGAPPLICATION FOR GRANT OF LONG- TERM ACCESS TO ISTS • Application for LTA can be made by a Generating station including a captive generating plant, a consumer, an electricity trader or distribution licensee, a State Government owning some quantum of power. • LTA can be availed for any period between 12 years to 25 years and might require construction of new transmission capacities. • in the application for LTA, the applicant shall be required to indicate location of the load point on the grid of the entity or entities to whom electricity is proposed to be supplied and the location of the source point on the grid of the entity from whom electricity is proposed to be sourced, along with the quantum of power to be transferred
  • 67.
    GRANT OF LONG-TERM ACCESS TO ISTS Contd… • PROCESSING OF APPLICATIONS – The applications shall be processed on first-come-first- served basis. The applications received during a month and up to the last day of the month shall be construed to have arrived concurrently. In case of applications received by post, the date of receipt of application at POWERGRID office shall be considered as the date of application. – The nodal agency i.e, POWERGRID shall carry out system studies in ISTS to examine the adequacy of the transmission system
  • 68.
    GRANT OF LONG-TERM ACCESS TO ISTS Contd… • BULK POWER TRANSMISSION AGREEMENT (BPTA) – Bulk Power Transmission Agreement (BPTA) shall be signed by the applicant with POWERGRID, agreeing therein to pay transmission charges for use of the existing and additional regional and/or inter-regional transmission system as per billing system in vogue at that time. • Scheduling of Long Term Bilateral Transaction – The scheduling, including the Load Despatch Centre under whose jurisdiction the applicant will fall, curtailment and revision of schedule of LTA transactions shall be as per the Regulations. While scheduling on day-ahead basis, long-term access customers would have the highest priority, followed by medium term customers and then followed by short-term customers • TRANSMISSION SYSTEM CONSTRAINTS – In case of curtailment becoming necessary as result of deviation by the applicant from final dispatch and drawl schedule intimated by RLDC, the use of such inter-State system shall be curtailed first, to the full extent of such deviation, following which the principle specified in following sub-clause 5.3 shall apply. – In case of curtailment of capacity by RLDC/NLDC, transmission charges payable shall remain unaffected.
  • 69.
    GRANT OF LONG-TERM ACCESS TO ISTS Contd… • Renewal of Term for Long-term access On the expiry of the period of long-term access, the long-term access shall stand extended on a written request provided by the long-term customer in this regard to the Central Transmission Utility mentioning the period for extension that is required. Further, such a written request shall be submitted by the long term customer to the Central Transmission Utility at least six months prior to the date of expiry of the long-term access. In case no written request is received from the long-term customer within the timeline specified above, the said long-term access shall stand withdrawn. • Relinquishment of access rights A long-term customer may relinquish the long-term access rights fully or partly before the expiry of the full term of long-term access, by making payment of compensation for stranded capacity as follows:- 1. Long-term customer who has availed access rights for at least 12 years (i) Notice of one (1) year – If such a customer submits an application to the CTU at least 1 (one) year prior to the date from which such customer desires to relinquish the access rights, there shall be no charges. (ii) Notice of less than one (1) year – If such a customer submits an application to the CTU at any time lesser than a period of 1 (one) year prior to the date from which such customer desires to relinquish the access rights, such customer shall pay an amount equal to 66% of the estimated transmission charges (net present value) for the stranded transmission capacity for the period falling short of a notice period of one (1) year.
  • 70.
    GRANT OF LONG-TERM ACCESS TO ISTS Contd… • Long-term customer who has not availed access rights for at least 12 (twelve) years – such customer shall pay an amount equal to 66% of the estimated transmission charges (net present value) for the stranded transmission capacity for the period falling short of 12 (twelve) years of access rights. Such a customer shall submit an application to the CTU at least 1 (one) year prior to the date from which such customer desires to relinquish the access rights. In case a customer submits an application for relinquishment of long-term access rights at any time at a notice period of less than one year, then such customer shall pay an amount equal to 66% of the estimated transmission charges (net present value) for the period falling short of a notice period of one (1) year, in addition to 66% of the estimated transmission charges (net present value) for the stranded transmission capacity for the period falling short of 12 (twelve) years of access rights. • The discount rate that shall be applicable for computing the net present value as referred to above shall be the discount rate to be used for bid evaluation in the Commission‟s Notification issued from time to time in accordance with the Guidelines for Determination of Tariff by Bidding Process for Procurement of Power by Distribution Licensees issued by the Ministry of Power. • The compensation paid by the long-term customer for the stranded transmission capacity shall be used for reducing transmission charges payable by other long-term customers and medium-term customers in the year in which such compensation payment is due in the ratio of transmission charges payable for that year by such long-term customers and medium-term customers.
  • 71.
    GRANT OF LONG-TERM ACCESS TO ISTS Contd… • General – The applicant shall keep the nodal agency and RLDC/NLDC indemnified at all times and shall undertake to indemnify, defend and keep the nodal agency, RLDC/NLDC harmless from any and all damages, losses, claims and actions including those relating to injury to or death of any person or damage to property, demands, suits, recoveries, costs and expenses, court costs, attorney fees, and all other obligations by or to third parties, arising out of or resulting from the long-term access transaction. – Any amendment/modification to an existing application, except for reasons specifically mentioned in the procedure, shall be treated as a fresh application. – All costs/expenses/charges associated with the application, including bank draft, bank guarantee etc. shall be borne by the applicant. – Payment of transmission charges, fees and charges for the concerned RLDC and SLDC as well as transmission charges for the RLDC, unscheduled inter-change charges etc. as applicable shall be made by the applicant as per the Regulations. – The applicant shall abide by the provisions of the Electricity Act, 2003, the Regulations and Indian Electricity Grid Code , as amended from time to time. – This procedure aims at easy and pragmatic disposal of applications made for Long-term Access in ISTS. However, some teething problems may still be experienced. The various implications would be known only after practical experience is gained by way of implementing these procedures. In order to resolve the same, this procedure shall be reviewed or revised by the Nodal agency with prior approval of CERC. – All complaints regarding unfair practices, delays, discrimination, lack of information, supply of wrong information
  • 72.
    REFERENCES • http://indianpowersector.com/home/open-access/oa-charges/# • http://indianpowersector.com/home/tag/atc-losses/ •http://www.iepa.com/wheeling.asp • http://www.iexindia.com/ • http://reconnectenergy.com/blog/2015/03/uperc-final-solar-rooftop-regulation- 2015/ • http://www.cercind.gov.in/ • http://www.powerexindia.com/
  • 73.
