Olympic Village School Capital Project
What is the project about?

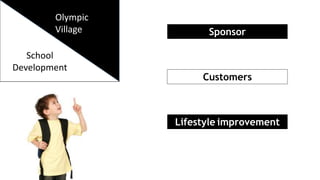

Olympic
Village Sponsor
Customers
Lifestyle improvement

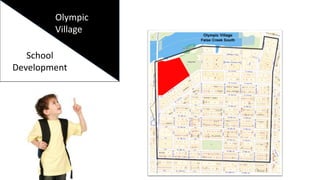

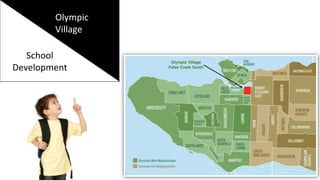

School
Development
Olympic
Village
Olympic
Village History
Location
Lifestyle improvement
School
Development
Olympic
Village
School
Development
Olympic
Village
School
Development
Olympic
Village
School
Development
Olympic
Village

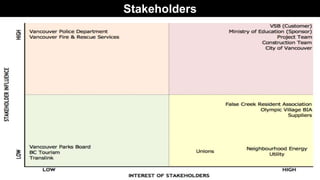

Stakeholders
Schools preparation

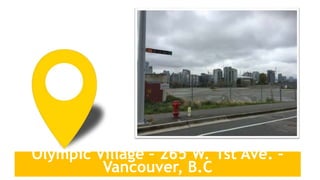

Olympic Village – 265 W. 1st Ave. –
Vancouver, B.C

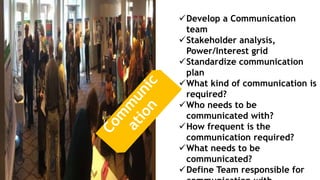

Develop a Communication
team
Stakeholder analysis,
Power/Interest grid
Standardize communication
plan
What kind of communication is
required?
Who needs to be
communicated with?
How frequent is the
communication required?
What needs to be
communicated?
Define Team responsible for

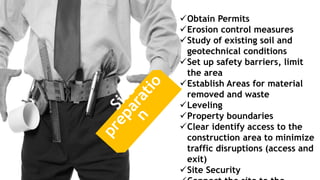

Obtain Permits
Erosion control measures
Study of existing soil and
geotechnical conditions
Set up safety barriers, limit
the area
Establish Areas for material
removed and waste
Leveling
Property boundaries
Clear identify access to the
construction area to minimize
traffic disruptions (access and
exit)
Site Security
Provide accessible parking, with
required pavement markings and
signs, as required by municipal
regulations and BC Building Code
Define Contractors Area. Offices
,storage site ,kitchens, bathrooms
Heavy Equipment ,define
location, Develop plans to reduce
the risk ( Insurance)
Site Clean Up, collect / remove
waste on a regular basis
Dumpsters, Construction Bins &
Hoarding
Construction Protection & Safety
Guidelines
Portable Toilets - clearly identified
Smoking Areas, an outdoor
Signal Areas to protect
(Olympic Village Dog Park,
Lake), surrounding the
construction area
Acoustic considerations
Define work areas
Emergency exits
Waste Area
Site maintenance (Cleaning)
Time Schedules
Trees and plants
Elementary school
Most
importan
t asset
300
Studen
ts
Kindergar
300
Stude
nts
Grade 7
13 Classrooms – 24 Students
2 Flex rooms

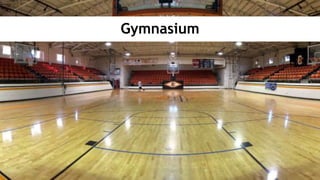

Gymnasium

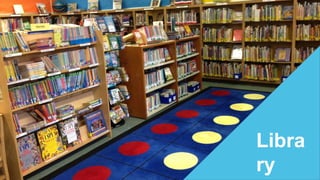

Libra
ry

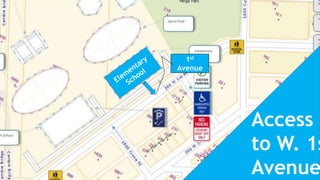

Access
to W. 1s
Avenue
1st
Avenue
LEED
First step
Secondary school
600
Stude
nts
Grades
8 - 12
12 Classrooms – 50 Students
2 science laboratory classrooms
3 Flex rooms
Gymnasium
Libra
ry
Auditor
Access
to W. 1s
Avenue
Sports field
Used by general public after school and
weekends.

Location
Ministry of Culture and Recreation
standards.
Length: 360
feet
Width: 160 feet
End Zone:10
yards
Length: 260
feet
Width: 160 feet
End Zone:10
yards
High
School
Elementary
School
Playground

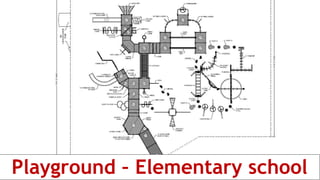

Playground – Elementary school
Playground – Elementary school
 Wheel Chair
Accessible
 Promotes
healthy
exercise for
elementary
students
during school
Playground – Elementary school
 LED lighting to
allow for night
play
 Promote sport
activity for
secondary
school students
 Tennis Courts
available for
public use after
Tennis Courts
Waterpark
 Encourages outside play for
children
Safe play area with non-slip
surface and minimal water
levels
Accessible to the public ( free
)
Benefits of splash pads
S
c
h
e
d
u
l
e

Deliverable Work Activity Duration Wk 1 Wk 2 Wk 3 Wk 4 Wk 5 Wk 6 Wk 7 Wk 8 Wk 9 Wk 10 Wk 11 Wk 12 Wk 13 Wk 14 Wk 15 Wk 16 Wk 17 Wk 18 Wk 19 Wk 20 Wk 21 Wk 22 Wk 23 Wk 24 Wk 25 Wk 26 Wk 27 Wk 28 Wk 29 Wk 30 Wk 31 Wk 32 Wk 33 Wk 34 Wk 35 Wk 36 Wk 37 Wk 38
1
Site
Preparation
1.1 Site info meeting/media 2 w
1.2 Site security 1 w
1.3 Environmental requirements 2 w
1.4 Traffic/pedestrian control 3 w
1.5 Prepare/contract heavy equipment 3 w
1.6 Contractor set up 2 d
1.7 Safety orientations 2 d
1.8 Health and safety plan 3 d
2
Elementary
School
2.1 Excavate 3 d
2.2 Lay slab foundation 1 w
2.3 Seismic and structural framing 4 w
2.4 Roofing and ceiling structure 2 w
2.5 Windows, doors, and exterior cladding 1 w
2.6 Internal finishings 8 w
2.7 Review and complete deficiencies 2 w
2.8 Connect access road to Wylie Street 4 d
3 High School
3.1 Excavate 2 w
3.2 Lay parking garage foundation 2 w
3.3 First floor, second floor and seismic installations 10 w
3.4 Roofing and ceiling structure 4 w
3.5 Windows, doors, and exterior cladding 2 w
3.6 Internal finishings 12 w
3.7 Review and complete deficiencies 3 w
3.8 Connect access road to Crowe Street 4 d
4
Two sports
fields &
baseball
diamond
4.1 Field excavation to sub-grade 4 d
4.2 Install perimeter concrete curb 2 w
4.3
Install geotextile fabric and field underdrain
system
1 w
4.4 Install free draining base and finish stone 1 w
4.5 Off-load turf rolls and place turf 1 w
4.6 Sew turf panels 4 d
4.7 Apply field markings and decorative markings 3 d
4.8 Install infill 3 d
5
Water park,
playground &
tennis courts
5.1
Prepare ground for water park, tennis courts and
playground
2 d
5.2 Build forms and pour concrete for water park 3 d
5.3 Pour concrete for tennis courts 1 d
5.4 Install water fixtures for water park 2 d
5.5 Assemble children's playground 4 d
5.6
Install lighting and perimeter fence for tennis
courts
4 d
5.7
Complete concrete walkways around water park
and wading pool
1 w
5.8
Frame playground area using lumber and
organic soft fall fill material
4 d

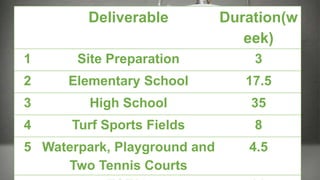

Deliverable Duration(w
eek)
1 Site Preparation 3
2 Elementary School 17.5
3 High School 35
4 Turf Sports Fields 8
5 Waterpark, Playground and
Two Tennis Courts
4.5

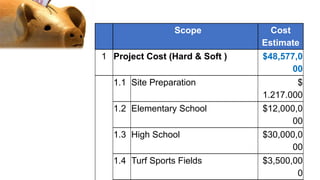

Budget
Scope Cost
Estimate
1 Project Cost (Hard & Soft ) $48,577,0
00
1.1 Site Preparation $
1.217.000
1.2 Elementary School $12,000,0
00
1.3 High School $30,000,0
00
1.4 Turf Sports Fields $3,500,00
0

Project Gates
Gates
Life
cycle
Confirm the project adheres to a
defined action plan
• Financially rationale
• Meets the expected level of
quality
 Oversight for this project is
provided by the Ministry of Education
• Strategic alignment with the
Ministry’s goals
Gates
Life
cycle
Confirm the project adheres to a
defined action plan
• Financially rationale
• Meets the expected level of
quality
 Oversight for this project is
provided by the Ministry of Education
• Strategic alignment with the
Ministry’s goals
Gates
Life
cycle
Initialing Process
Planning Process
Executing Process
Closing Process
Gate 1
Approve charter
and proceed to
planning process
Gate 2
Approve
recommended plan
and proceed to
pre-design process
Gate 3
Set baselines and
proceed to
executing process
Gate 4
Briefing at
substantial
completion
Risk
analysi
s

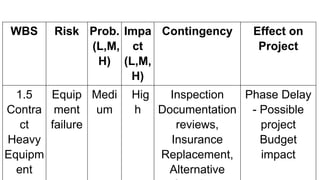

WBS Risk Prob.
(L,M,
H)
Impa
ct
(L,M,
H)
Contingency Effect on
Project
1.5
Contra
ct
Heavy
Equipm
ent
Equip
ment
failure
Medi
um
Hig
h
Inspection
Documentation
reviews,
Insurance
Replacement,
Alternative
Phase Delay
- Possible
project
Budget
impact
WBS Risk Prob.
(L,M,
H)
Impa
ct
(L,M,
H)
Contingency Effect on
Project

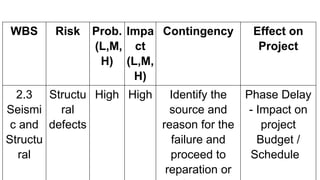

2.3
Seismi
c and
Structu
ral
Structu
ral
defects
High High Identify the
source and
reason for the
failure and
proceed to
reparation or
Phase Delay
- Impact on
project
Budget /
Schedule
WBS Risk Prob.
(L,M,
H)
Impa
ct
(L,M,
H)
Contingency Effect on
Project
3.6
Internal
Finishi
ng
Termina
tion
deficien
cies
Medi
um
Medi
um
Identify
responsible,
repaired as
specified by
the project
Alternative
Phase Delay
- Impact on
project
Budget /
Schedule
WBS Risk Prob.
(L,M,H)
Impa
ct
(L,M,
H)
Contingency Effect on
Project

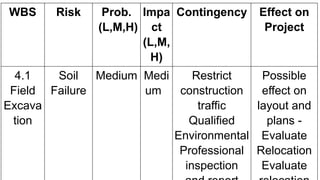

4.1
Field
Excava
tion
Soil
Failure
Medium Medi
um
Restrict
construction
traffic
Qualified
Environmental
Professional
inspection
Possible
effect on
layout and
plans -
Evaluate
Relocation
Evaluate
WBS Risk Prob.
(L,M,
H)
Impa
ct
(L,M,
H)
Contingency Effect on
Project
5.3
Concre
te for
Tennis
court
Failures
in
concret
e,
cracks
Medi
um
High Identify
causes of and
possible
alternatives for
permanent
repairs
Possible
effect on
layout and
plans -
Alternative
Evaluate
Procurement

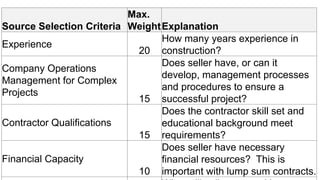

Source Selection Criteria
Max.
WeightExplanation
Experience
20
How many years experience in
construction?
Company Operations
Management for Complex
Projects
15
Does seller have, or can it
develop, management processes
and procedures to ensure a
successful project?
Contractor Qualifications
15
Does the contractor skill set and
educational background meet
requirements?
Financial Capacity
10
Does seller have necessary
financial resources? This is
important with lump sum contracts.
Proposed Design
15
Does the design meet all
customers requirements and
comply with sustainability and
ethical considerations?
Quality
5
Can seller’s technical
methodologies, techniques and
solutions meet the technical
requirements in the procurement
documents?
Time
5
With what degree of confidence
can the seller produce the
product within the specified
deadline?
Does proposal address the
No Key results areas Key performance indicators Description Weight of KPIs How often Target
Key Performance Indicators
Actual cost/
Baseline costs
=
1
Actual
Completion ratio/
Baseline
completion ratio
=
1
90% Satisfied
0 defects
Cash Balance
Day to day project completion
ratio
Employee satisfaction
Defects
4
4
3
4
It will be comparing the
actual completion ratio and
the baseline, dividing the
actual completion rate by the
baseline completion rate to
make sure the project is on
time.
Measuring how content or
satisfied employees are with
their jobs
This ratio is a measure of
defects produced biweekly
Dayly
Monthly
Weekly
2 .
3 .
4 .
5 .
Balanced budget
To be according to the Schedule
People management
Quality control
1 .
Safety and Security at work Number of accidents 5 0 accidents
It will be measuring how
many accidents the
construction of the school
has per day, for the
occupational safety, the
focus is on serious accidents.
It will be comparing the
actual cost versus baseline,
dividing the actual cost by
the baseline provides
clarification for the project's
budget.
Weekly
weekly
To recap
Life cycle of facilities
Long term benefits
Thank you
Responsible
Carrie, Dario, Humberto, Lee,
Nancy and Renato
More information?
www.olympicvillageschool.ca
projectovs@email.com
+1-(777)-999-1234
“Education is the single most important job of the human race”
George Lucas

Olympic Village Project FINAL

  • 1.
    Olympic Village SchoolCapital Project
  • 2.
    What is theproject about?
  • 3.
  • 4.
  • 5.
  • 6.
  • 7.
  • 8.
  • 9.
  • 10.
    Olympic Village –265 W. 1st Ave. – Vancouver, B.C
  • 12.
    Develop a Communication team Stakeholderanalysis, Power/Interest grid Standardize communication plan What kind of communication is required? Who needs to be communicated with? How frequent is the communication required? What needs to be communicated? Define Team responsible for
  • 13.
    Obtain Permits Erosion controlmeasures Study of existing soil and geotechnical conditions Set up safety barriers, limit the area Establish Areas for material removed and waste Leveling Property boundaries Clear identify access to the construction area to minimize traffic disruptions (access and exit) Site Security
  • 14.
    Provide accessible parking,with required pavement markings and signs, as required by municipal regulations and BC Building Code Define Contractors Area. Offices ,storage site ,kitchens, bathrooms Heavy Equipment ,define location, Develop plans to reduce the risk ( Insurance) Site Clean Up, collect / remove waste on a regular basis Dumpsters, Construction Bins & Hoarding Construction Protection & Safety Guidelines Portable Toilets - clearly identified Smoking Areas, an outdoor
  • 15.
    Signal Areas toprotect (Olympic Village Dog Park, Lake), surrounding the construction area Acoustic considerations Define work areas Emergency exits Waste Area Site maintenance (Cleaning) Time Schedules Trees and plants
  • 16.
  • 18.
  • 19.
  • 20.
  • 21.
    13 Classrooms –24 Students
  • 22.
  • 23.
  • 24.
  • 25.
  • 26.
  • 27.
  • 28.
  • 29.
  • 30.
    12 Classrooms –50 Students
  • 31.
  • 32.
  • 33.
  • 34.
  • 35.
  • 36.
  • 37.
  • 38.
    Used by generalpublic after school and weekends. Location
  • 39.
    Ministry of Cultureand Recreation standards. Length: 360 feet Width: 160 feet End Zone:10 yards Length: 260 feet Width: 160 feet End Zone:10 yards High School Elementary School
  • 40.
  • 41.
    Playground – Elementaryschool  Wheel Chair Accessible  Promotes healthy exercise for elementary students during school
  • 42.
  • 43.
     LED lightingto allow for night play  Promote sport activity for secondary school students  Tennis Courts available for public use after Tennis Courts
  • 44.
  • 45.
     Encourages outsideplay for children Safe play area with non-slip surface and minimal water levels Accessible to the public ( free ) Benefits of splash pads
  • 46.
  • 47.
    Deliverable Work ActivityDuration Wk 1 Wk 2 Wk 3 Wk 4 Wk 5 Wk 6 Wk 7 Wk 8 Wk 9 Wk 10 Wk 11 Wk 12 Wk 13 Wk 14 Wk 15 Wk 16 Wk 17 Wk 18 Wk 19 Wk 20 Wk 21 Wk 22 Wk 23 Wk 24 Wk 25 Wk 26 Wk 27 Wk 28 Wk 29 Wk 30 Wk 31 Wk 32 Wk 33 Wk 34 Wk 35 Wk 36 Wk 37 Wk 38 1 Site Preparation 1.1 Site info meeting/media 2 w 1.2 Site security 1 w 1.3 Environmental requirements 2 w 1.4 Traffic/pedestrian control 3 w 1.5 Prepare/contract heavy equipment 3 w 1.6 Contractor set up 2 d 1.7 Safety orientations 2 d 1.8 Health and safety plan 3 d 2 Elementary School 2.1 Excavate 3 d 2.2 Lay slab foundation 1 w 2.3 Seismic and structural framing 4 w 2.4 Roofing and ceiling structure 2 w 2.5 Windows, doors, and exterior cladding 1 w 2.6 Internal finishings 8 w 2.7 Review and complete deficiencies 2 w 2.8 Connect access road to Wylie Street 4 d 3 High School 3.1 Excavate 2 w 3.2 Lay parking garage foundation 2 w 3.3 First floor, second floor and seismic installations 10 w 3.4 Roofing and ceiling structure 4 w 3.5 Windows, doors, and exterior cladding 2 w 3.6 Internal finishings 12 w 3.7 Review and complete deficiencies 3 w 3.8 Connect access road to Crowe Street 4 d 4 Two sports fields & baseball diamond 4.1 Field excavation to sub-grade 4 d 4.2 Install perimeter concrete curb 2 w 4.3 Install geotextile fabric and field underdrain system 1 w 4.4 Install free draining base and finish stone 1 w 4.5 Off-load turf rolls and place turf 1 w 4.6 Sew turf panels 4 d 4.7 Apply field markings and decorative markings 3 d 4.8 Install infill 3 d 5 Water park, playground & tennis courts 5.1 Prepare ground for water park, tennis courts and playground 2 d 5.2 Build forms and pour concrete for water park 3 d 5.3 Pour concrete for tennis courts 1 d 5.4 Install water fixtures for water park 2 d 5.5 Assemble children's playground 4 d 5.6 Install lighting and perimeter fence for tennis courts 4 d 5.7 Complete concrete walkways around water park and wading pool 1 w 5.8 Frame playground area using lumber and organic soft fall fill material 4 d
  • 48.
    Deliverable Duration(w eek) 1 SitePreparation 3 2 Elementary School 17.5 3 High School 35 4 Turf Sports Fields 8 5 Waterpark, Playground and Two Tennis Courts 4.5
  • 49.
  • 50.
    Scope Cost Estimate 1 ProjectCost (Hard & Soft ) $48,577,0 00 1.1 Site Preparation $ 1.217.000 1.2 Elementary School $12,000,0 00 1.3 High School $30,000,0 00 1.4 Turf Sports Fields $3,500,00 0
  • 51.
  • 52.
    Gates Life cycle Confirm the projectadheres to a defined action plan • Financially rationale • Meets the expected level of quality  Oversight for this project is provided by the Ministry of Education • Strategic alignment with the Ministry’s goals
  • 53.
    Gates Life cycle Confirm the projectadheres to a defined action plan • Financially rationale • Meets the expected level of quality  Oversight for this project is provided by the Ministry of Education • Strategic alignment with the Ministry’s goals
  • 54.
    Gates Life cycle Initialing Process Planning Process ExecutingProcess Closing Process Gate 1 Approve charter and proceed to planning process Gate 2 Approve recommended plan and proceed to pre-design process Gate 3 Set baselines and proceed to executing process Gate 4 Briefing at substantial completion
  • 55.
  • 56.
    WBS Risk Prob. (L,M, H) Impa ct (L,M, H) ContingencyEffect on Project 1.5 Contra ct Heavy Equipm ent Equip ment failure Medi um Hig h Inspection Documentation reviews, Insurance Replacement, Alternative Phase Delay - Possible project Budget impact
  • 57.
    WBS Risk Prob. (L,M, H) Impa ct (L,M, H) ContingencyEffect on Project 2.3 Seismi c and Structu ral Structu ral defects High High Identify the source and reason for the failure and proceed to reparation or Phase Delay - Impact on project Budget / Schedule
  • 58.
    WBS Risk Prob. (L,M, H) Impa ct (L,M, H) ContingencyEffect on Project 3.6 Internal Finishi ng Termina tion deficien cies Medi um Medi um Identify responsible, repaired as specified by the project Alternative Phase Delay - Impact on project Budget / Schedule
  • 59.
    WBS Risk Prob. (L,M,H) Impa ct (L,M, H) ContingencyEffect on Project 4.1 Field Excava tion Soil Failure Medium Medi um Restrict construction traffic Qualified Environmental Professional inspection Possible effect on layout and plans - Evaluate Relocation Evaluate
  • 60.
    WBS Risk Prob. (L,M, H) Impa ct (L,M, H) ContingencyEffect on Project 5.3 Concre te for Tennis court Failures in concret e, cracks Medi um High Identify causes of and possible alternatives for permanent repairs Possible effect on layout and plans - Alternative Evaluate
  • 61.
  • 62.
    Source Selection Criteria Max. WeightExplanation Experience 20 Howmany years experience in construction? Company Operations Management for Complex Projects 15 Does seller have, or can it develop, management processes and procedures to ensure a successful project? Contractor Qualifications 15 Does the contractor skill set and educational background meet requirements? Financial Capacity 10 Does seller have necessary financial resources? This is important with lump sum contracts.
  • 63.
    Proposed Design 15 Does thedesign meet all customers requirements and comply with sustainability and ethical considerations? Quality 5 Can seller’s technical methodologies, techniques and solutions meet the technical requirements in the procurement documents? Time 5 With what degree of confidence can the seller produce the product within the specified deadline? Does proposal address the
  • 65.
    No Key resultsareas Key performance indicators Description Weight of KPIs How often Target Key Performance Indicators Actual cost/ Baseline costs = 1 Actual Completion ratio/ Baseline completion ratio = 1 90% Satisfied 0 defects Cash Balance Day to day project completion ratio Employee satisfaction Defects 4 4 3 4 It will be comparing the actual completion ratio and the baseline, dividing the actual completion rate by the baseline completion rate to make sure the project is on time. Measuring how content or satisfied employees are with their jobs This ratio is a measure of defects produced biweekly Dayly Monthly Weekly 2 . 3 . 4 . 5 . Balanced budget To be according to the Schedule People management Quality control 1 . Safety and Security at work Number of accidents 5 0 accidents It will be measuring how many accidents the construction of the school has per day, for the occupational safety, the focus is on serious accidents. It will be comparing the actual cost versus baseline, dividing the actual cost by the baseline provides clarification for the project's budget. Weekly weekly
  • 66.
  • 67.
    Life cycle offacilities
  • 68.
  • 69.
  • 70.
    Responsible Carrie, Dario, Humberto,Lee, Nancy and Renato More information? www.olympicvillageschool.ca projectovs@email.com +1-(777)-999-1234 “Education is the single most important job of the human race” George Lucas
