The Smart Cities Mission
PREPARED BY: PROF. D.V.PATEL
2

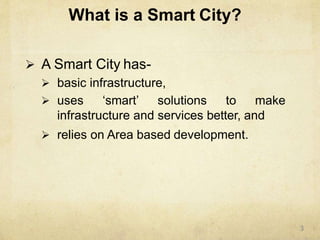

What is a Smart City?
 A Smart City has-
 basic infrastructure,
 uses ‘smart’ solutions to make
infrastructure and services better, and
 relies on Area based development.
3
4

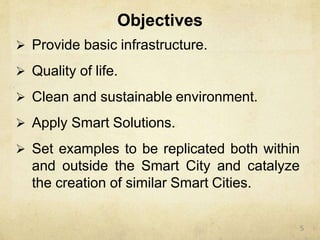

Objectives
 Provide basic infrastructure.
 Quality of life.
 Clean and sustainable environment.
 Apply Smart Solutions.
 Set examples to be replicated both within
and outside the Smart City and catalyze
the creation of similar Smart Cities.
5
6

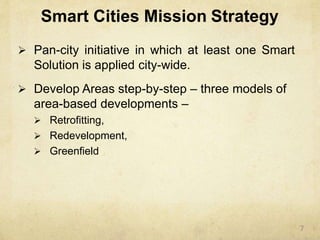

Smart Cities Mission Strategy
 Pan-city initiative in which at least one Smart
Solution is applied city-wide.
 Develop Areas step-by-step – three models of
area-based developments –
 Retrofitting,
 Redevelopment,
 Greenfield
7

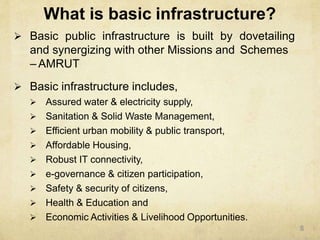

What is basic infrastructure?
 Basic public infrastructure is built by dovetailing
and synergizing with other Missions and Schemes
– AMRUT
 Basic infrastructure includes,
 Assured water & electricity supply,
 Sanitation & Solid Waste Management,
 Efficient urban mobility & public transport,
 Affordable Housing,
 Robust IT connectivity,
 e-governance & citizen participation,
 Safety & security of citizens,
 Health & Education and
 Economic Activities & Livelihood Opportunities.

8

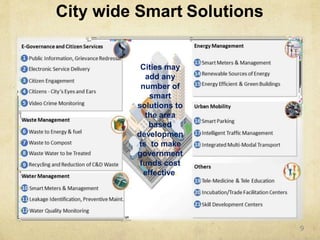

City wide Smart Solutions
Cities may
add any
number of
smart
solutions to
the area
based
developmen
ts to make
government
funds cost
effective.
9

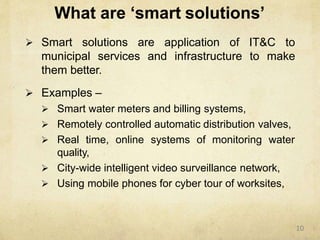

What are ‘smart solutions’
 Smart solutions are application of IT&C to
municipal services and infrastructure to make
them better.
 Examples –

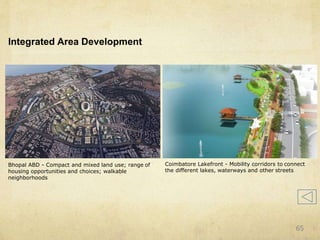

 Smart water meters and billing systems,
 Remotely controlled automatic distribution valves,
 Real time, online systems of monitoring water
quality,
 City-wide intelligent video surveillance network,
 Using mobile phones for cyber tour of worksites,
10

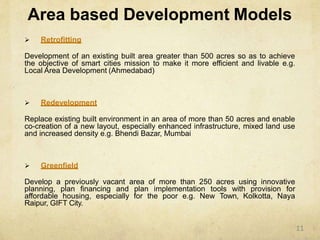

Area based Development Models
 Retrofitting
Development of an existing built area greater than 500 acres so as to achieve
the objective of smart cities mission to make it more efficient and livable e.g.
Local Area Development (Ahmedabad)
 Redevelopment
Replace existing built environment in an area of more than 50 acres and enable
co-creation of a new layout, especially enhanced infrastructure, mixed land use
and increased density e.g. Bhendi Bazar, Mumbai
 Greenfield
Develop a previously vacant area of more than 250 acres using innovative
planning, plan financing and plan implementation tools with provision for
affordable housing, especially for the poor e.g. New Town, Kolkotta, Naya
Raipur, GIFT City.
11

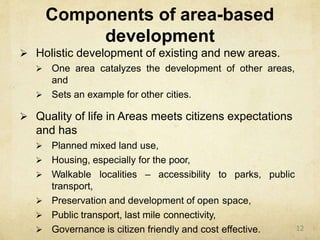

Components of area-based
development
 Holistic development of existing and new areas.
 One area catalyzes the development of other areas,
and
 Sets an example for other cities.
 Quality of life in Areas meets citizens expectations
and has
 Planned mixed land use,
 Housing, especially for the poor,
public Walkable localities – accessibility to parks,
transport,
 Preservation and development of open space,
 Public transport, last mile connectivity,
 Governance is citizen friendly and cost effective. 12

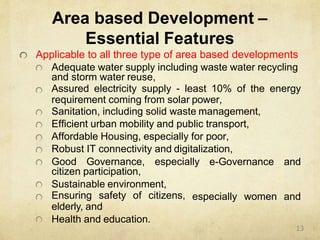

Area based Development –
Essential Features
Applicable to all three type of area based developments
Adequate water supply including waste water recycling
and storm water reuse,
Assured electricity supply - least 10% of the energy
requirement coming from solar power,
Sanitation, including solid waste management,
Efficient urban mobility and public transport,
Affordable Housing, especially for poor,
Robust IT connectivity and digitalization,
e-Governance andGood Governance, especially
citizen participation,
Sustainable environment,
especially women andEnsuring safety of citizens,
elderly, and
Health and education.
13

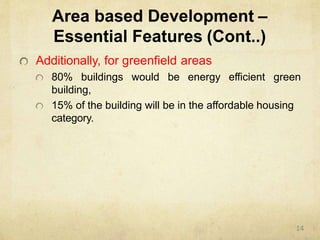

Area based Development –
Essential Features (Cont..)
Additionally, for greenfield areas
80% buildings would be energy efficient green
building,
15% of the building will be in the affordable housing
category.
14

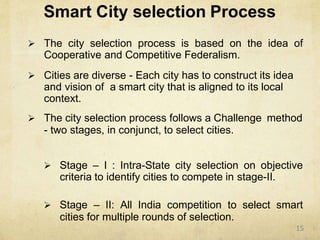

Smart City selection Process
 The city selection process is based on the idea of
Cooperative and Competitive Federalism.
 Cities are diverse - Each city has to construct its idea
and vision of a smart city that is aligned to its local
context.
 The city selection process follows a Challenge method
- two stages, in conjunct, to select cities.
 Stage – I : Intra-State city selection on objective
criteria to identify cities to compete in stage-II.
 Stage – II: All India competition to select smart
cities for multiple rounds of selection.
15
SMART CITY Selection Process
16
City Selection Criteria

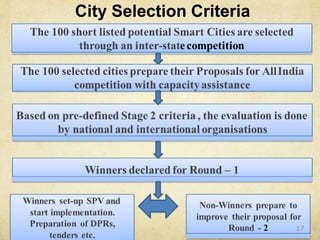

17

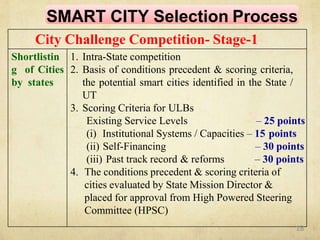

City Challenge Competition- Stage-1
Shortlistin
g of Cities
by states
1. Intra-State competition
2. Basis of conditions precedent & scoring criteria,
the potential smart cities identified in the State /
UT
3. Scoring Criteria for ULBs
Existing Service Levels – 25 points
(i) Institutional Systems / Capacities – 15 points
(ii) Self-Financing – 30 points
(iii) Past track record & reforms – 30 points
4. The conditions precedent & scoring criteria of
cities evaluated by State Mission Director &
placed for approval from High Powered Steering
Committee (HPSC)
SMART CITY Selection Process
18

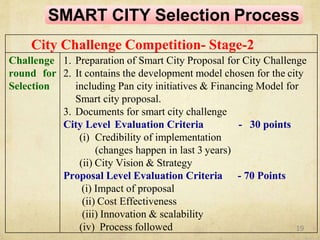

City Challenge Competition- Stage-2
Challenge
round for
Selection
1. Preparation of Smart City Proposal for City Challenge
2. It contains the development model chosen for the city
including Pan city initiatives & Financing Model for
Smart city proposal.
3. Documents for smart city challenge
City Level Evaluation Criteria - 30 points
(i) Credibility of implementation
(changes happen in last 3 years)
(ii) City Vision & Strategy
Proposal Level Evaluation Criteria - 70 Points
(i) Impact of proposal
(ii) Cost Effectiveness
(iii) Innovation & scalability
(iv) Process followed
SMART CITY Selection Process
19
20

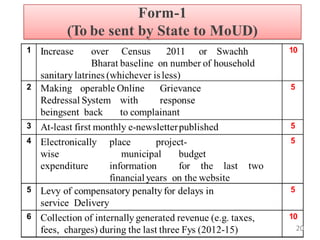

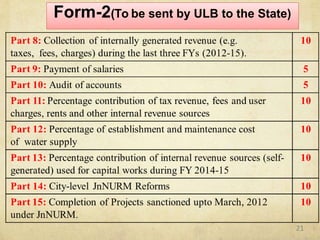

Form-2(To be sent by ULB to the State)
21
22
23

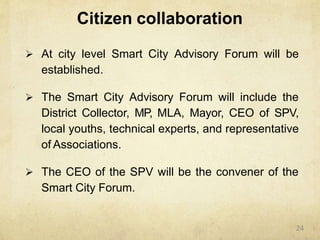

Citizen collaboration
 At city level Smart City Advisory Forum will be
established.
 The Smart City Advisory Forum will include the
District Collector, MP, MLA, Mayor, CEO of SPV,
local youths, technical experts, and representative
of Associations.
 The CEO of the SPV will be the convener of the
Smart City Forum.
24
25

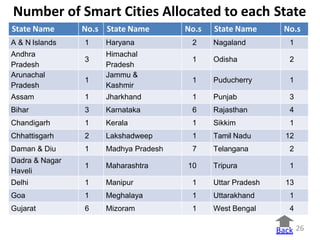

Number of Smart Cities Allocated to each State
State Name No.s State Name No.s State Name No.s
A & N Islands 1 Haryana 2 Nagaland 1
Andhra
Pradesh
3
Himachal
Pradesh
1 Odisha 2
Arunachal
Pradesh
1
Jammu &
Kashmir
1 Puducherry 1
Assam 1 Jharkhand 1 Punjab 3
Bihar 3 Karnataka 6 Rajasthan 4
Chandigarh 1 Kerala 1 Sikkim 1
Chhattisgarh 2 Lakshadweep 1 Tamil Nadu 12
Daman & Diu 1 Madhya Pradesh 7 Telangana 2
Dadra & Nagar
Haveli
1 Maharashtra 10 Tripura 1
Delhi 1 Manipur 1 Uttar Pradesh 13
Goa 1 Meghalaya 1 Uttarakhand 1
Gujarat 6 Mizoram 1 West Bengal 4
Back 26

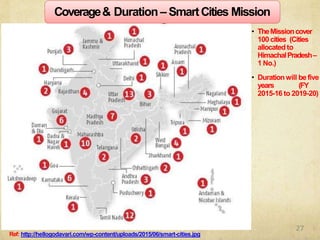

Coverage& Duration – SmartCities Mission
• TheMissioncover
100 cities (Cities
allocatedto
HimachalPradesh–
1 No.)
• Durationwill befive
years (FY
2015-16 to 2019-20)
Ref: http://hellogodavari.com/wp-content/uploads/2015/06/smart-cities.jpg
27

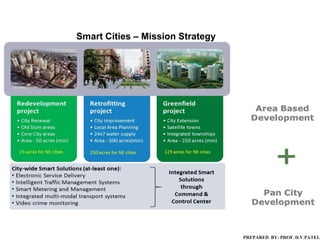

Smart Cities – Mission Strategy
PREPARED BY: PROF. D.V.PATEL
Four rounds of competition
Round 1 Round 2 Round 3 Round 4 Total
No. of Selected Cities 20 40 30 10* 100
Period of selection Jan 2016
May to Sep
2016
Jun 2017 Jan 2018
Total no. of Projects 829 1,959 1,891 472 5,151
Investment (in ₹Crores) 48,064 83,698 57,393 15,863 2,05,018
Avg. SCP Size
(in ₹Crores)
2,403 2,092 1,913 1,586 2,050
*Shillong selected as 100th Smart City in June2018
Financial Landscape
100 Smart Cities to make
investment of ₹2.05 lakh crore
29
Implementation Timeline

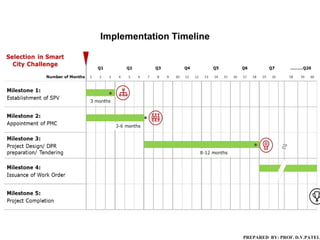

PREPARED BY: PROF. D.V.PATEL

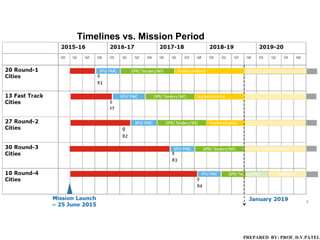

Timelines vs. Mission Period
5
PREPARED BY: PROF. D.V.PATEL
6

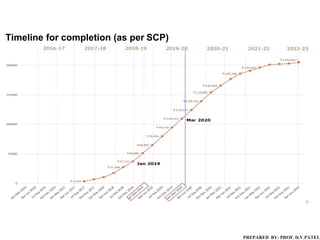

Timeline for completion (as per SCP)
PREPARED BY: PROF. D.V.PATEL

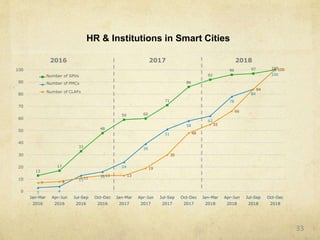

HR & Institutions in Smart Cities
13
17
33
48
59 60
71
86
92
96
3 4
24
39
51
58
62
78
100
7 8
1311 1613 13
19
30
48
55
66
84
84
100100
0
10
20
30
40
50
60
70
80
90
100
Jan-Mar Apr-Jun Jul-Sep Oct-Dec Jan-Mar Apr-Jun Jul-Sep Oct-Dec Jan-Mar Apr-Jun Jul-Sep Oct-Dec
2016 2016 2016 2016 2017 2017 2017 2017 2018 2018 2018 2018
Number of SPVs
Number of PMCs
Number of CLAFs
2016 2017 2018
97
33
23,228
30,355
33,970
36,291
39,039
43,914
48,629 50,048 50,254
63,169
65,142
76,721
90,929
85,099
1,02,027
1,04,484
16,523
11,952
19,041
20,600
24,867
27,047
30,333 30,887 31,144
38,807 39,554
46,322
50,042
51,866
59,336
61,553
-
20,000
40,000
60,000
80,000
1,00,000
1,20,000
27 Oct
2017
30 Nov
2017
29 Dec
2017
02 Feb
2018
01 Mar
2018
01 Apr
2018
01 May
2018
01 Jun
2018
29 Jun
2018
17 Aug
2018
31 Aug
2018
28 Sep
2018
29 Oct
2018
30 Nov
2018
31 Dec
2018
23 Jan
2019
Value of Tendered Projects (Rs. Crore)
Value of Grounded/Completed Projects (Rs. Crore)

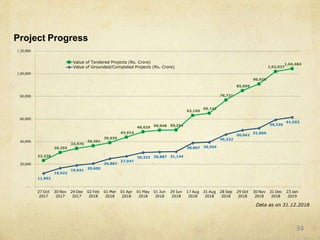

Project Progress
Data as on 31.12.2018
34
649 774 869 1,001 1,046 1,220 1,321 1,363 1,383 1,686 1,747 2,067 2,221 2,342 2,563 2,725
30,355
23,228
33,970
36,291
43,914
39,039
48,629 50,048 50,254
63,169
65,142
76,721
90,929
85,099
1,02,027
1,04,484
-
500
1,000
1,500
2,000
2,500
3,000
-
20,000
40,000
60,000
80,000
1,00,000
1,20,000
27 Oct
2017
30 Nov
2017
29 Dec
2017
02 Feb
2018
01 Mar
2018
01 Apr
2018
01 May
2018
01 Jun
2018
29 Jun
2018
17 Aug
2018
31 Aug
2018
28 Sep
2018
29 Oct
2018
30 Nov
2018
31 Dec
2018
23 Jan
2019
Number of Projects Cost
(Rs. crore)

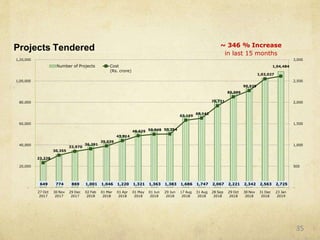

Projects Tendered ~ 346 % Increase
in last 15 months
35

436 539 610 705 752 845 925 953 982 1199 1219 1492 1613 1675 1842 2005
11,952
16,523
19,041
20,600
24,867
27,047
30,333 30,887 31,144
38,807 39,554
46,322
51,866
50,042
59,336
61,553
0
500
1000
1500
2000
2500
-
10,000
20,000
30,000
40,000
50,000
60,000
70,000
27 Oct
2017
30 Nov
2017
29 Dec
2017
02 Feb
2018
01 Mar
2018
01 Apr
2018
01 May
2018
01 Jun
2018
29 Jun
2018
17 Aug
2018
31 Aug
2018
28 Sep
2018
29 Oct
2018
30 Nov
2018
31 Dec
2018
23 Jan
2019
Number of Projects Cost
(Rs. crore)

Projects Grounded ~ 413 % Increase
in last 15 months
36
128 147 170 207 240 274 309 318 320 421 427 471 518 525 587 599
1,742 1,872
2,238
2,455
4,438
4,662
4,893
5,249 5,269
7,842 7,873
8,854
9,971 10,079
10,817 10,915
0
100
200
300
400
500
600
700
-
2,000
4,000
6,000
8,000
10,000
12,000
27 Oct
2017
30 Nov
2017
29 Dec
2017
02 Feb
2018
01 Mar
2018
01 Apr
2018
01 May
2018
01 Jun
2018
29 Jun
2018
17 Aug
2018
31 Aug
2018
28 Sep
2018
29 Oct
2018
30 Nov
2018
31 Dec
2018
23 Jan
2019
Number of Projects Cost
(Rs. crore)
Projects Completed ~ 527 % Increase
in last 15 months
37
Larger projects taken up in later stages… (>250 cr)
12
12
10
8
6
4
2
Sep-18 Apr-19
0
Jan-16 Jul-16 Feb-17 Aug-17 Mar-18
Tendered projects (costing more than Rs 250 crore), since inception of SCM
38

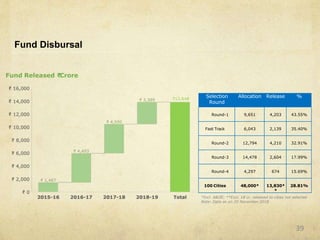

Fund Disbursal
₹13,848
Fund Released ₹Crore
Selection
Round
Allocation Release %
Round-1 9,651 4,203 43.55%
Fast Track 6,043 2,139 35.40%
Round-2 12,794 4,210 32.91%
Round-3 14,478 2,604 17.99%
Round-4 4,297 674 15.69%
100 Cities 48,000* 13,830*
*
28.81%
*Incl. A&OE; **Excl. 18 cr. released to cities not selected
Note: Data as on 20 November 2018
39

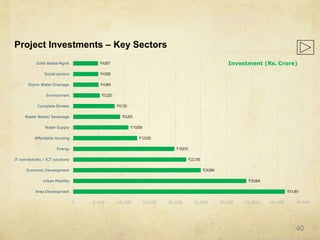

Project Investments – Key Sectors
₹41,481
₹33,904
₹24,984
₹22,156
₹19,815
₹12,530
₹10,839
₹9,205
₹8,135
₹5,220
₹4,964
₹4,926
₹4,857
0 5,000 10,000 15,000 20,000 25,000 30,000 35,000 40,000 45,000
Area Development
Urban Mobility
Economic Development
IT connectivity / ICT solutions
Energy
Affordable Housing
Water Supply
Waste Water/ Sewerage
Complete Streets
Environment
Storm Water Drainage
Social sectors
Solid Waste Mgmt Investment (Rs. Crore)
40
Innovation snapshots...
15
PREPARED BY: PROF. D.V.PATEL
16
42
43
Implementation
Ease of Living
Smart Governance
Connected Communities
Urban Resilience
WalkableStreets,Parks,
Waterfronts
SmartSchools,
Heritage,Arts&Culture
Command&Control
Centers,Mobile
Applications
SolarandWindEnergy,
Water&WasteWater,
WastetoEnergy
44
Implementation
Ease of Living
Connected Communities
Smart Governance
Urban Resilience
WalkableStreets,Parks,
Waterfronts
45
46

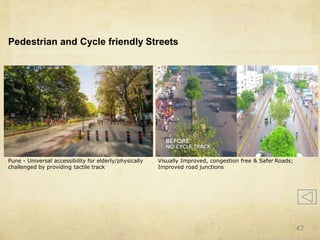

Pedestrian and Cycle friendly Streets
Pune - Universal accessibility for elderly/physically
challenged by providing tactile track
Visually Improved, congestion free & Safer Roads;
Improved road junctions
47
Pedestrian and Cycle friendly Streets
Upgradation of Church
Street, Bengaluru
48
Pedestrian and Cycle friendly Streets
Smart Janpath Project,
Bhubaneswar
49

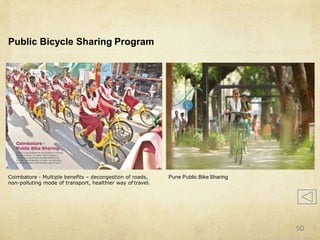

Public Bicycle Sharing Program
Coimbatore - Multiple benefits – decongestion of roads,
non-polluting mode of transport, healthier way of travel.
Pune Public Bike Sharing
50
Public Transport/ Multi-modal Transit Hub
PREPARED BY: PROF. D.V.PATEL
Smart Parking
PREPARED BY: PROF. D.V.PATEL
Electric Mobility
PREPARED BY: PROF. D.V.PATEL
54
55
56
Water Supply
Ahmedabad – Effective water supply operations with
SCADA implementation
Bhopal - Improved health & hygiene of
community through potable Water Supply
57
Smart Water
Guwahati Water ATM at Regional Center, Khanapara –
Automated Water Dispensing Units to provide safe
drinking water to floating population (at 20 locations)
NDMC Water ATM – Automated Water Dispensing Units
to provide safe drinking water to floating population
58
Sanitation - Smart Toilets
Bio Toilets near Guwahati Municipal Office Faridabad Smart Toilet at Sector 19 Market Solapur E-Toilets
59
60
61
62
Waterfront Development
Warangal - Bhadrakali Lakefront Promenede Project
aims to ensure ample recall of elements from city’s
rich built heritage
Ajmer - Enhanced public realm with the creation of
Anasagar lakefront pomenede and walkways
63

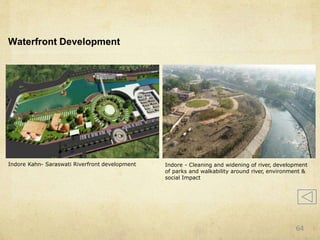

Waterfront Development
Indore Kahn- Saraswati Riverfront development Indore - Cleaning and widening of river, development
of parks and walkability around river, environment &
social Impact
64
Integrated Area Development
Bhopal ABD - Compact and mixed land use; range of
housing opportunities and choices; walkable
neighborhoods
Coimbatore Lakefront - Mobility corridors to connect
the different lakes, waterways and other streets
65
66
Development of Parks
and Open Spaces
67
Implementation
Ease of Living
Smart Governance
Connected Communities
Urban Resilience
Command&Control
Centers,Mobile
Applications
68

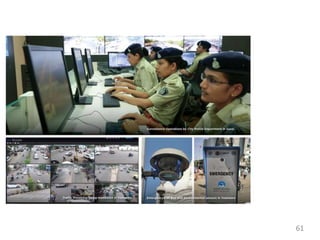

Integrated Command & Control Centers
PREPARED BY: PROF. D.V.PATEL
Integrated Command & Control Centers

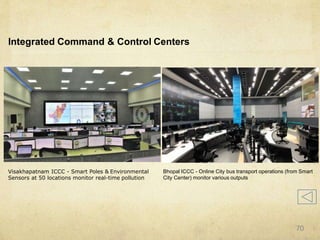

Visakhapatnam ICCC - Smart Poles & Environmental
Sensors at 50 locations monitor real-time pollution
Bhopal ICCC - Online City bus transport operations (from Smart
City Center) monitor various outputs
70
Integrated Command & Control Centers
Vadodara - 240% increase in public transport use after
introducing buses with GPS, PIS & Wi-Fi
Rajkot - Using undeniable video evidences, crime Rate
reduced by 18% over 2 quarters (Apr’18)
71
Smart Cards & Mobile Applications
Janmitra Mobility Card, Ahmedabad
Card can be used across public transportation modes like bus,
metro, water metro and also for mercantile and internet
transactions; Enhanced commuter experience, cashless
transactions
NDMC 311: Project Cost: 45 lakhs;
Implementation Status: Work Ongoing
72
Ahmedabad ITMS
PREPARED BY: PROF. D.V.PATEL
Implementation
Ease of Living
Smart Governance
Connected Communities
Urban Resilience
SmartSchools,
Heritage,Arts&Culture
74

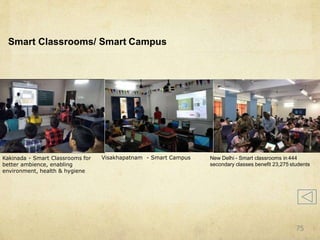

Smart Classrooms/ Smart Campus
Kakinada - Smart Classrooms for
better ambience, enabling
environment, health & hygiene
New Delhi - Smart classrooms in 444
secondary classes benefit 23,275 students
Visakhapatnam - Smart Campus
75
76
Pune Lighthouses empower unprivileged youth for sustainable livelihood generation
77
Economic Development
B NEST Incubation Center - Space designed to inspire
entrepreneurs, enterprises & government leaders
Pune Lighthouses empower unprivileged youth for
sustainable livelihood generation
78
79
Street Art and Mural Projects
PREPARED BY: PROF. D.V.PATEL
81

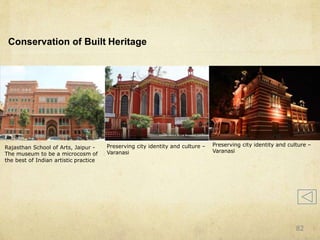

Conservation of Built Heritage
Rajasthan School of Arts, Jaipur -
The museum to be a microcosm of
the best of Indian artistic practice
Preserving city identity and culture –
Varanasi
Preserving city identity and culture –
Varanasi
82
Implementation
Ease of Living
Smart Governance
Connected Communities
Urban Resilience SolarandWindEnergy,
Water&WasteWater,
WastetoEnergy
83

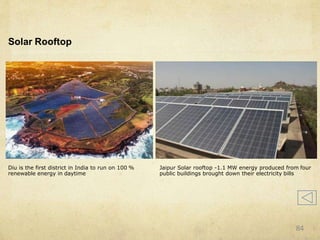

Solar Rooftop
Diu is the first district in India to run on 100 %
renewable energy in daytime
Jaipur Solar rooftop -1.1 MW energy produced from four
public buildings brought down their electricity bills
84
Solar Rooftop on Public
Buildings, Vizag
Floating Solar, Vizag
Solar Tree, Coimbatore
85
Waste to Energy Plant, Jabalpur
Bio Gas
Power Plant,
Surat
PREPARED BY: PROF. D.V.PATEL

Smart city

  • 1.
    The Smart CitiesMission PREPARED BY: PROF. D.V.PATEL
  • 2.
  • 3.
    What is aSmart City?  A Smart City has-  basic infrastructure,  uses ‘smart’ solutions to make infrastructure and services better, and  relies on Area based development. 3
  • 4.
  • 5.
    Objectives  Provide basicinfrastructure.  Quality of life.  Clean and sustainable environment.  Apply Smart Solutions.  Set examples to be replicated both within and outside the Smart City and catalyze the creation of similar Smart Cities. 5
  • 6.
  • 7.
    Smart Cities MissionStrategy  Pan-city initiative in which at least one Smart Solution is applied city-wide.  Develop Areas step-by-step – three models of area-based developments –  Retrofitting,  Redevelopment,  Greenfield 7
  • 8.
    What is basicinfrastructure?  Basic public infrastructure is built by dovetailing and synergizing with other Missions and Schemes – AMRUT  Basic infrastructure includes,  Assured water & electricity supply,  Sanitation & Solid Waste Management,  Efficient urban mobility & public transport,  Affordable Housing,  Robust IT connectivity,  e-governance & citizen participation,  Safety & security of citizens,  Health & Education and  Economic Activities & Livelihood Opportunities. 8
  • 9.
    City wide SmartSolutions Cities may add any number of smart solutions to the area based developmen ts to make government funds cost effective. 9
  • 10.
    What are ‘smartsolutions’  Smart solutions are application of IT&C to municipal services and infrastructure to make them better.  Examples –  Smart water meters and billing systems,  Remotely controlled automatic distribution valves,  Real time, online systems of monitoring water quality,  City-wide intelligent video surveillance network,  Using mobile phones for cyber tour of worksites, 10
  • 11.
    Area based DevelopmentModels  Retrofitting Development of an existing built area greater than 500 acres so as to achieve the objective of smart cities mission to make it more efficient and livable e.g. Local Area Development (Ahmedabad)  Redevelopment Replace existing built environment in an area of more than 50 acres and enable co-creation of a new layout, especially enhanced infrastructure, mixed land use and increased density e.g. Bhendi Bazar, Mumbai  Greenfield Develop a previously vacant area of more than 250 acres using innovative planning, plan financing and plan implementation tools with provision for affordable housing, especially for the poor e.g. New Town, Kolkotta, Naya Raipur, GIFT City. 11
  • 12.
    Components of area-based development Holistic development of existing and new areas.  One area catalyzes the development of other areas, and  Sets an example for other cities.  Quality of life in Areas meets citizens expectations and has  Planned mixed land use,  Housing, especially for the poor, public Walkable localities – accessibility to parks, transport,  Preservation and development of open space,  Public transport, last mile connectivity,  Governance is citizen friendly and cost effective. 12
  • 13.
    Area based Development– Essential Features Applicable to all three type of area based developments Adequate water supply including waste water recycling and storm water reuse, Assured electricity supply - least 10% of the energy requirement coming from solar power, Sanitation, including solid waste management, Efficient urban mobility and public transport, Affordable Housing, especially for poor, Robust IT connectivity and digitalization, e-Governance andGood Governance, especially citizen participation, Sustainable environment, especially women andEnsuring safety of citizens, elderly, and Health and education. 13
  • 14.
    Area based Development– Essential Features (Cont..) Additionally, for greenfield areas 80% buildings would be energy efficient green building, 15% of the building will be in the affordable housing category. 14
  • 15.
    Smart City selectionProcess  The city selection process is based on the idea of Cooperative and Competitive Federalism.  Cities are diverse - Each city has to construct its idea and vision of a smart city that is aligned to its local context.  The city selection process follows a Challenge method - two stages, in conjunct, to select cities.  Stage – I : Intra-State city selection on objective criteria to identify cities to compete in stage-II.  Stage – II: All India competition to select smart cities for multiple rounds of selection. 15
  • 16.
  • 17.
  • 18.
    City Challenge Competition-Stage-1 Shortlistin g of Cities by states 1. Intra-State competition 2. Basis of conditions precedent & scoring criteria, the potential smart cities identified in the State / UT 3. Scoring Criteria for ULBs Existing Service Levels – 25 points (i) Institutional Systems / Capacities – 15 points (ii) Self-Financing – 30 points (iii) Past track record & reforms – 30 points 4. The conditions precedent & scoring criteria of cities evaluated by State Mission Director & placed for approval from High Powered Steering Committee (HPSC) SMART CITY Selection Process 18
  • 19.
    City Challenge Competition-Stage-2 Challenge round for Selection 1. Preparation of Smart City Proposal for City Challenge 2. It contains the development model chosen for the city including Pan city initiatives & Financing Model for Smart city proposal. 3. Documents for smart city challenge City Level Evaluation Criteria - 30 points (i) Credibility of implementation (changes happen in last 3 years) (ii) City Vision & Strategy Proposal Level Evaluation Criteria - 70 Points (i) Impact of proposal (ii) Cost Effectiveness (iii) Innovation & scalability (iv) Process followed SMART CITY Selection Process 19
  • 20.
  • 21.
    Form-2(To be sentby ULB to the State) 21
  • 22.
  • 23.
  • 24.
    Citizen collaboration  Atcity level Smart City Advisory Forum will be established.  The Smart City Advisory Forum will include the District Collector, MP, MLA, Mayor, CEO of SPV, local youths, technical experts, and representative of Associations.  The CEO of the SPV will be the convener of the Smart City Forum. 24
  • 25.
  • 26.
    Number of SmartCities Allocated to each State State Name No.s State Name No.s State Name No.s A & N Islands 1 Haryana 2 Nagaland 1 Andhra Pradesh 3 Himachal Pradesh 1 Odisha 2 Arunachal Pradesh 1 Jammu & Kashmir 1 Puducherry 1 Assam 1 Jharkhand 1 Punjab 3 Bihar 3 Karnataka 6 Rajasthan 4 Chandigarh 1 Kerala 1 Sikkim 1 Chhattisgarh 2 Lakshadweep 1 Tamil Nadu 12 Daman & Diu 1 Madhya Pradesh 7 Telangana 2 Dadra & Nagar Haveli 1 Maharashtra 10 Tripura 1 Delhi 1 Manipur 1 Uttar Pradesh 13 Goa 1 Meghalaya 1 Uttarakhand 1 Gujarat 6 Mizoram 1 West Bengal 4 Back 26
  • 27.
    Coverage& Duration –SmartCities Mission • TheMissioncover 100 cities (Cities allocatedto HimachalPradesh– 1 No.) • Durationwill befive years (FY 2015-16 to 2019-20) Ref: http://hellogodavari.com/wp-content/uploads/2015/06/smart-cities.jpg 27
  • 28.
    Smart Cities –Mission Strategy PREPARED BY: PROF. D.V.PATEL
  • 29.
    Four rounds ofcompetition Round 1 Round 2 Round 3 Round 4 Total No. of Selected Cities 20 40 30 10* 100 Period of selection Jan 2016 May to Sep 2016 Jun 2017 Jan 2018 Total no. of Projects 829 1,959 1,891 472 5,151 Investment (in ₹Crores) 48,064 83,698 57,393 15,863 2,05,018 Avg. SCP Size (in ₹Crores) 2,403 2,092 1,913 1,586 2,050 *Shillong selected as 100th Smart City in June2018 Financial Landscape 100 Smart Cities to make investment of ₹2.05 lakh crore 29
  • 30.
  • 31.
    Timelines vs. MissionPeriod 5 PREPARED BY: PROF. D.V.PATEL
  • 32.
    6 Timeline for completion(as per SCP) PREPARED BY: PROF. D.V.PATEL
  • 33.
    HR & Institutionsin Smart Cities 13 17 33 48 59 60 71 86 92 96 3 4 24 39 51 58 62 78 100 7 8 1311 1613 13 19 30 48 55 66 84 84 100100 0 10 20 30 40 50 60 70 80 90 100 Jan-Mar Apr-Jun Jul-Sep Oct-Dec Jan-Mar Apr-Jun Jul-Sep Oct-Dec Jan-Mar Apr-Jun Jul-Sep Oct-Dec 2016 2016 2016 2016 2017 2017 2017 2017 2018 2018 2018 2018 Number of SPVs Number of PMCs Number of CLAFs 2016 2017 2018 97 33
  • 34.
    23,228 30,355 33,970 36,291 39,039 43,914 48,629 50,048 50,254 63,169 65,142 76,721 90,929 85,099 1,02,027 1,04,484 16,523 11,952 19,041 20,600 24,867 27,047 30,33330,887 31,144 38,807 39,554 46,322 50,042 51,866 59,336 61,553 - 20,000 40,000 60,000 80,000 1,00,000 1,20,000 27 Oct 2017 30 Nov 2017 29 Dec 2017 02 Feb 2018 01 Mar 2018 01 Apr 2018 01 May 2018 01 Jun 2018 29 Jun 2018 17 Aug 2018 31 Aug 2018 28 Sep 2018 29 Oct 2018 30 Nov 2018 31 Dec 2018 23 Jan 2019 Value of Tendered Projects (Rs. Crore) Value of Grounded/Completed Projects (Rs. Crore) Project Progress Data as on 31.12.2018 34
  • 35.
    649 774 8691,001 1,046 1,220 1,321 1,363 1,383 1,686 1,747 2,067 2,221 2,342 2,563 2,725 30,355 23,228 33,970 36,291 43,914 39,039 48,629 50,048 50,254 63,169 65,142 76,721 90,929 85,099 1,02,027 1,04,484 - 500 1,000 1,500 2,000 2,500 3,000 - 20,000 40,000 60,000 80,000 1,00,000 1,20,000 27 Oct 2017 30 Nov 2017 29 Dec 2017 02 Feb 2018 01 Mar 2018 01 Apr 2018 01 May 2018 01 Jun 2018 29 Jun 2018 17 Aug 2018 31 Aug 2018 28 Sep 2018 29 Oct 2018 30 Nov 2018 31 Dec 2018 23 Jan 2019 Number of Projects Cost (Rs. crore) Projects Tendered ~ 346 % Increase in last 15 months 35
  • 36.
    436 539 610705 752 845 925 953 982 1199 1219 1492 1613 1675 1842 2005 11,952 16,523 19,041 20,600 24,867 27,047 30,333 30,887 31,144 38,807 39,554 46,322 51,866 50,042 59,336 61,553 0 500 1000 1500 2000 2500 - 10,000 20,000 30,000 40,000 50,000 60,000 70,000 27 Oct 2017 30 Nov 2017 29 Dec 2017 02 Feb 2018 01 Mar 2018 01 Apr 2018 01 May 2018 01 Jun 2018 29 Jun 2018 17 Aug 2018 31 Aug 2018 28 Sep 2018 29 Oct 2018 30 Nov 2018 31 Dec 2018 23 Jan 2019 Number of Projects Cost (Rs. crore) Projects Grounded ~ 413 % Increase in last 15 months 36
  • 37.
    128 147 170207 240 274 309 318 320 421 427 471 518 525 587 599 1,742 1,872 2,238 2,455 4,438 4,662 4,893 5,249 5,269 7,842 7,873 8,854 9,971 10,079 10,817 10,915 0 100 200 300 400 500 600 700 - 2,000 4,000 6,000 8,000 10,000 12,000 27 Oct 2017 30 Nov 2017 29 Dec 2017 02 Feb 2018 01 Mar 2018 01 Apr 2018 01 May 2018 01 Jun 2018 29 Jun 2018 17 Aug 2018 31 Aug 2018 28 Sep 2018 29 Oct 2018 30 Nov 2018 31 Dec 2018 23 Jan 2019 Number of Projects Cost (Rs. crore) Projects Completed ~ 527 % Increase in last 15 months 37
  • 38.
    Larger projects takenup in later stages… (>250 cr) 12 12 10 8 6 4 2 Sep-18 Apr-19 0 Jan-16 Jul-16 Feb-17 Aug-17 Mar-18 Tendered projects (costing more than Rs 250 crore), since inception of SCM 38
  • 39.
    Fund Disbursal ₹13,848 Fund Released₹Crore Selection Round Allocation Release % Round-1 9,651 4,203 43.55% Fast Track 6,043 2,139 35.40% Round-2 12,794 4,210 32.91% Round-3 14,478 2,604 17.99% Round-4 4,297 674 15.69% 100 Cities 48,000* 13,830* * 28.81% *Incl. A&OE; **Excl. 18 cr. released to cities not selected Note: Data as on 20 November 2018 39
  • 40.
    Project Investments –Key Sectors ₹41,481 ₹33,904 ₹24,984 ₹22,156 ₹19,815 ₹12,530 ₹10,839 ₹9,205 ₹8,135 ₹5,220 ₹4,964 ₹4,926 ₹4,857 0 5,000 10,000 15,000 20,000 25,000 30,000 35,000 40,000 45,000 Area Development Urban Mobility Economic Development IT connectivity / ICT solutions Energy Affordable Housing Water Supply Waste Water/ Sewerage Complete Streets Environment Storm Water Drainage Social sectors Solid Waste Mgmt Investment (Rs. Crore) 40
  • 41.
  • 42.
  • 43.
  • 44.
    Implementation Ease of Living SmartGovernance Connected Communities Urban Resilience WalkableStreets,Parks, Waterfronts SmartSchools, Heritage,Arts&Culture Command&Control Centers,Mobile Applications SolarandWindEnergy, Water&WasteWater, WastetoEnergy 44
  • 45.
    Implementation Ease of Living ConnectedCommunities Smart Governance Urban Resilience WalkableStreets,Parks, Waterfronts 45
  • 46.
  • 47.
    Pedestrian and Cyclefriendly Streets Pune - Universal accessibility for elderly/physically challenged by providing tactile track Visually Improved, congestion free & Safer Roads; Improved road junctions 47
  • 48.
    Pedestrian and Cyclefriendly Streets Upgradation of Church Street, Bengaluru 48
  • 49.
    Pedestrian and Cyclefriendly Streets Smart Janpath Project, Bhubaneswar 49
  • 50.
    Public Bicycle SharingProgram Coimbatore - Multiple benefits – decongestion of roads, non-polluting mode of transport, healthier way of travel. Pune Public Bike Sharing 50
  • 51.
    Public Transport/ Multi-modalTransit Hub PREPARED BY: PROF. D.V.PATEL
  • 52.
  • 53.
  • 54.
  • 55.
  • 56.
  • 57.
    Water Supply Ahmedabad –Effective water supply operations with SCADA implementation Bhopal - Improved health & hygiene of community through potable Water Supply 57
  • 58.
    Smart Water Guwahati WaterATM at Regional Center, Khanapara – Automated Water Dispensing Units to provide safe drinking water to floating population (at 20 locations) NDMC Water ATM – Automated Water Dispensing Units to provide safe drinking water to floating population 58
  • 59.
    Sanitation - SmartToilets Bio Toilets near Guwahati Municipal Office Faridabad Smart Toilet at Sector 19 Market Solapur E-Toilets 59
  • 60.
  • 61.
  • 62.
  • 63.
    Waterfront Development Warangal -Bhadrakali Lakefront Promenede Project aims to ensure ample recall of elements from city’s rich built heritage Ajmer - Enhanced public realm with the creation of Anasagar lakefront pomenede and walkways 63
  • 64.
    Waterfront Development Indore Kahn-Saraswati Riverfront development Indore - Cleaning and widening of river, development of parks and walkability around river, environment & social Impact 64
  • 65.
    Integrated Area Development BhopalABD - Compact and mixed land use; range of housing opportunities and choices; walkable neighborhoods Coimbatore Lakefront - Mobility corridors to connect the different lakes, waterways and other streets 65
  • 66.
  • 67.
  • 68.
    Implementation Ease of Living SmartGovernance Connected Communities Urban Resilience Command&Control Centers,Mobile Applications 68
  • 69.
    Integrated Command &Control Centers PREPARED BY: PROF. D.V.PATEL
  • 70.
    Integrated Command &Control Centers Visakhapatnam ICCC - Smart Poles & Environmental Sensors at 50 locations monitor real-time pollution Bhopal ICCC - Online City bus transport operations (from Smart City Center) monitor various outputs 70
  • 71.
    Integrated Command &Control Centers Vadodara - 240% increase in public transport use after introducing buses with GPS, PIS & Wi-Fi Rajkot - Using undeniable video evidences, crime Rate reduced by 18% over 2 quarters (Apr’18) 71
  • 72.
    Smart Cards &Mobile Applications Janmitra Mobility Card, Ahmedabad Card can be used across public transportation modes like bus, metro, water metro and also for mercantile and internet transactions; Enhanced commuter experience, cashless transactions NDMC 311: Project Cost: 45 lakhs; Implementation Status: Work Ongoing 72
  • 73.
  • 74.
    Implementation Ease of Living SmartGovernance Connected Communities Urban Resilience SmartSchools, Heritage,Arts&Culture 74
  • 75.
    Smart Classrooms/ SmartCampus Kakinada - Smart Classrooms for better ambience, enabling environment, health & hygiene New Delhi - Smart classrooms in 444 secondary classes benefit 23,275 students Visakhapatnam - Smart Campus 75
  • 76.
  • 77.
    Pune Lighthouses empowerunprivileged youth for sustainable livelihood generation 77
  • 78.
    Economic Development B NESTIncubation Center - Space designed to inspire entrepreneurs, enterprises & government leaders Pune Lighthouses empower unprivileged youth for sustainable livelihood generation 78
  • 79.
  • 80.
    Street Art andMural Projects PREPARED BY: PROF. D.V.PATEL
  • 81.
  • 82.
    Conservation of BuiltHeritage Rajasthan School of Arts, Jaipur - The museum to be a microcosm of the best of Indian artistic practice Preserving city identity and culture – Varanasi Preserving city identity and culture – Varanasi 82
  • 83.
    Implementation Ease of Living SmartGovernance Connected Communities Urban Resilience SolarandWindEnergy, Water&WasteWater, WastetoEnergy 83
  • 84.
    Solar Rooftop Diu isthe first district in India to run on 100 % renewable energy in daytime Jaipur Solar rooftop -1.1 MW energy produced from four public buildings brought down their electricity bills 84
  • 85.
    Solar Rooftop onPublic Buildings, Vizag Floating Solar, Vizag Solar Tree, Coimbatore 85
  • 86.
    Waste to EnergyPlant, Jabalpur Bio Gas Power Plant, Surat PREPARED BY: PROF. D.V.PATEL
