Medalist i3070 08.30p
          Software Release

                                 Medalist In-Circuit Test 08.30p Software Release
                                                               Agilent Confidential
Page 1                                                                  July 2012
Agenda

   1. Software Milestone

   2. What’s new in 08.30p?

   3. How to get 08.30p?

                           Medalist In-Circuit Test 08.30p Software Release
                                                         Agilent Confidential
Page 2                                                            July 2012
Agenda

   1. Software Milestone
     • Software Release Milestone
     • Change Request List
   2. What’s new in 08.30p?

   3. How to get 08.30p?

                                    Medalist In-Circuit Test 08.30p Software Release
                                                                  Agilent Confidential
Page 3                                                                     July 2012

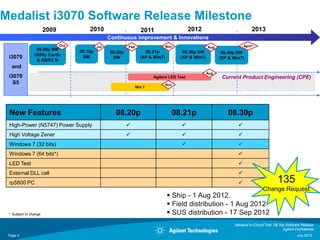

Medalist i3070 Software Release Milestone
                       2009             2010                        2011                     2012                             2013
                                                   Continuous Improvement & Innovations
                              Oct            Jul            Feb                   Nov                 Aug                April*
                 08.00p SW          08.10p         08.20p             08.21p             08.30p SW           08.40p SW
                Utility Cards
 i3070                               SW             SW              (XP & Win7)         (XP & Win7)         (XP & Win7)
                 & ASRU N
  and
                                                                                                      Aug
 i3070                                                                    Agilent LED Test                   Current Product Engineering (CPE)
   S5                                                                             Nov
                                                                  Win 7

 New Features                                         08.20p                        08.21p                     08.30p
 High-Power (N5747) Power Supply                                                                                   
 High Voltage Zener                                                                                                
 Windows 7 (32 bits)                                                                                                
 Windows 7 (64 bits*)                                                                                                
 LED Test                                                                                                            

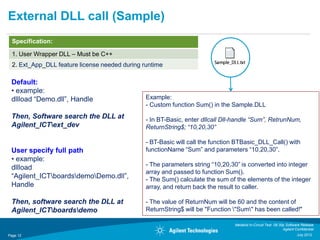

 External DLL call                                                                                                   
 rp5800 PC                                                                                                                                   135
                                                                                                                                    Change Request
                                                                                   Ship - 1 Aug 2012.
                                                                                   Field distribution - 1 Aug 2012
 * Subject to change                                                               SUS distribution - 17 Sep 2012
                                                                                                                   Medalist In-Circuit Test 08.30p Software Release
                                                                                                                                                 Agilent Confidential
 Page 4                                                                                                                                                   July 2012

Appendix: Change Request List - 1
CR ID      Title                                                                      CR ID     Title
CR27877    Unable to compile analog cluster (magic test) at PBD                       CR34143   quick report doesn't find all tests
CR29362    07.00pf: Board Consultant: Range for Tolerance Multiplier Is Incorrect     CR34150   ASRU N diagnostics failure 2824
CR33453    i3070 : ERROR!! result from Browser Locator Find Probe action              CR34152   08.20a: Support Info closes automatically
           i3070: Controllerloop causes measurement timeout in analog portion of      CR34154   Alternate PC portable based dongle pin card programming
CR33602    mixed test                                                                 CR34156   To remove MIL-STD-45662A wording from NIST CAL testplan
           i3070SW: Panel testplan subroutine Program_Flash does not declare          CR34159   08.20p "load board" command takes longer time to finish
CR33604    variables True                                                             CR34162   3070SW: icap card: fixture auto- unlocked during reboot.
           08.10: Support Info-Readme Under Control Panel For Agilent IO 15.5 not     CR34163   Add lost heart beat message and time stamp in pmlog
CR33842    working                                                                              Data polling in flash isp test does not work with xtp firmware version
CR33922    08.10: CA: Tested in parallel incorrect coverage count                     CR34165   10071517
CR33962    Digital setup editor would shutdown                                        CR34166   enhance ASRU cal 4395 and 4396 to write and check tracking feature
CR33990    customer requests an ability to call DLL command libraries                 CR34167   i3070: Enh Req to inhibit auto-converting to Multiple Board Versions
CR34045    08.20:Engineer GUI, More then one "GL" boxes can be checked                          i3070 8.20p: need to select FPY/WPR view each time Operator GUI is
CR34048    program memory exceeded                                                    CR34170   launched
CR34080    08.20 DGN Display Failure issue                                                      DC capacitor test causing subsequent test with "ed" option failed or
CR34085    08.20 : Browser : Personality Pins cannot browse                           CR34175   timeout
CR34090    parse board and board_xy for conflicts when loading in operator GUI        CR34177   NPM Issue encounterred in 08.20p
CR34099    Get statement automatically writes name in the title bar of BT-Basic       CR34179   08.20: ASRU N Diagnostic Failure T2824 - Improve yield
CR34100    Automated display backslashes as slashes in BT-Basic Title                 CR34180   08.20p: Wrong Error message for ASRU Calibration
CR34111    preferences setting in the board directory and User home directory         CR34181   Pushbutton Debug Window closes when Marking a Test as permanent.
CR34116    To enable ASRU N to work under UNIX as ASRU C / D                                    08.20b: By default, FPY and WPR should be tick check after operator GUI
CR34119    Should auto check "En" option if sense "A" is used                         CR34182   start
CR34126    08:20 Agilent Coverage Analyst got wrong Revision                          CR34183   08.20b: No revision info display in i3070 Medalist
CR34127    08.20: TTFXT_HP6621 compile config failed                                            08.20b: Installed Window Service for Unix cause issue in control of
           08.20: Engineer GUI : Incorrect message for ar value of less than 18 for   CR34185   testhead
CR34133    HVZ                                                                                  08.20: CA: BScan,CE and SN not reported as Test Technique used in
           symlink & iNode not working in TTDB GUI Panel test strategy when using     CR34190   Executive Sum
CR34136    NFS                                                                        CR34191   Coverage Analyst not handling Preshorts and Powered Analog correctly
           08.20p: HVZ_TTDB mark permanent or commented cause prepowered                        NIST Calibration Testplan uses Wrong Units for Temperature in Report
CR34139    erase in testorder                                                         CR34192   Header
CR34142    digital test reports error from AUX which is not used                      CR34200   i3070 8.x: BT-Basic Internal Error -13 at 'select boards on panel'
                                                                                                Relay Locator Diagram for unmux hybrid shows incorrect reference
                                                                                      CR34204   designators
                                                                                                                              Medalist In-Circuit Test 08.30p Software Release
                                                                                                                                                            Agilent Confidential
  Page 6                                                                                                                                                             July 2012

Appendix: Change Request List - 2
CR ID   Title                                                                         CR ID     Title
CR34208 Xvision Install error if i3070 sw is removed and re-installed 0820p                     Mixed Test failing line numbers and calling sequence not displayed in
        08.20p: BSDL parser does not flag single-ended, differential pins as          CR34249   PBDebug
CR34209 errors                                                                        CR34252   i3070 8.00p: Unility Card mux power supply wiring failed
CR34214 4 Languages Software License Term                                                       08.20: CA: Panel : Wrong report:tested devices reported as untested &
        Making Diagnose Relay licensing requirement same for Mux and                  CR34254   vice versa
CR34215 Unmux                                                                         CR34258   i3070: ConnectCheck learned value not save in PBDebug
        3070: The BSDL compiler does not issue a warning for part 4 of rule           CR34259   08.20e: PBD : Internal Error -11 opening a digital test
CR34216 B.8.18.4u).                                                                             08.20e:UnMUX:T342 Control 3 Real Math Error running the Analog_Tests
CR34218 08.30: Default xtp.xsvf file is 02020812_1 instead of 11060116_1              CR34260   subroutine
        08.30: Installation: Missing link (file) to Medalist i3070 software install             08.20pe: Angela board; Bt Basic encounter internal error when call
CR34219 help                                                                          CR34262   Analog_Test
        08.30: DGN new Test 8 (cal date & stored data) implemented on                 CR34263   i3070: Actel STAPL not compatible with 3070 PLD ISP
CR34220 Unmux                                                                         CR34265   extra line of 'sequencer halted' in digital failure message
CR34221 08.30 : DGN : Request to identify module # for T4396                          CR34266   08.20e : vcllib.exe error during lib compile
        08.30 : Expired cal: Calibration Message for testh is 1 is incorrect &        CR34268   IPG select inaccessible nodes in .discharge test
CR34223 clearable                                                                     CR34269   i3070: ICT Browser and Engineer GUI "Error in File Type: board"
CR34224 08.30:No Program_pin_card lic "Program Cards" is still enabled in DGN         CR34270   breaking recycle to fail for polarity test causes Pascal system error 8
CR34227 i3070: ENH REQ Board Consultant should display more than 5 boards             CR34271   Display Graphics menu is grey out for Polarity test in Pushbutton debug
        i3070 8.x: ENH REQ board setting for IPG to write AC cap test or DC cap       CR34276   08.30 Uninstall, SCO Vision hang during uninstall
CR34228 test                                                                          CR34277   08.30p Engineer Gui AIC Left Table duplicate column for CPK
        i3070: ENH REQ FXT53 WARNING message much obvious for                         CR34278   08.30p Installation,AgilentIO encounter error 1722 if use fresh WinXP HD
CR34229 insufficient access                                                           CR34279   Need the maximum Instruction Register length to be increased
CR34230 08.20: Hang on xvision uninstallation of 08.20p                               CR34281   08.30p Engineer GUI - Missing Permanent column in AIC Left Table
CR34231 With rev 0820p it's not possible to open Setup Editor                                   08.30p Testh power off - Failure in Medalist operator gui and Btbasic
CR34236 i3070 8.x: Conversion Tool needs updating for 8.x software                    CR34282   window
        08.30:Oper GUI: Implement saved setting to show/hide FPY/WPR on               CR34288   08.30 BtBasic, GPIB timeout when do 'testhead is 1'
CR34237 Chinese locale                                                                CR34290   Coverage Analyst hangs at Binding Test and Board Data
CR34239 i3070 08.xx: Improve file checking efficience over network                              08.30 Wrong Control XTP seq FPGA version, expected version is
CR34240 I3070HW: Nasru Cards are reporting 3374/3376 Errors.                          CR34291   11060116_1
        Testplan statements itb$ and num cause missing characters on display          CR34292   3070 GUI hangup on 2lvl fn calls
CR34248 and in logs

                                                                                                                             Medalist In-Circuit Test 08.30p Software Release
                                                                                                                                                           Agilent Confidential
Page 7                                                                                                                                                              July 2012
Appendix: Change Request List - 3
CR ID     Title                                                                     CR ID     Title
CR34293   Stapl compiler does not parse arithmetic assignment properly              CR34329   Recommend new kind of wiring for CET Card to prevent CET burnout
CR34294   N6751A DUT power supply fail DGN Test number 2340-DPS ground fault        CR34330   Support uVTEP with license control
CR34295   08.30: Program Asru encounter software internal error                     CR34334   08.30: Outdated Agilent copyright year info
CR34297   8.30p IPG Test Consultant GUI -Selected Directory Contents issue          CR34336   08.30: ASRU N Diagnostic Failure T2283 - Improve yield
CR34301   Timer functions to capture test time at board or sub-test level           CR34337   Enhanced 6M 12M hybrid mixable in testhead
CR34305   Needs auxconnect that does not release when press STOP
                                                                                    CR34338   08.30: To add an error variable parameter for external dll commands
CR34306   Histogram failed to generate on failing tests (i3070 Medalist)
                                                                                              08.30p IPG TestConsultant - Run Test Cell Manager window caption
CR34308   Quick Report does not report new hardware                                 CR34339   wrong
CR34311   Enable back ps6751
                                                                                    CR34340   08.30p BtBasic caption missing ""
CR34312   Control XTP Psync Error
                                                                                    CR34346   Boolean array assignment and syntax error line number display
CR34318   Browser cannot display a panelized board in Bank 1
                                                                                    CR34348   08.30: Q-Stats report Histogram type encounter hang
CR34319   08.30: Cannot launch BScan Chain Viewer
CR34321   08:30: Testhead cannot boot successfully in RP5800 controller             CR34349   08.30: PBD_Edit menu execute Copy and Paste failed and cause GUI hang
CR34322   Incorrect .discharge file causes relay damage                             CR34350   08.30: PPU_without credit button still can load board and run ICT test
          debug end causes bt-basic hang when digital waveform window is the        CR34357   08.30p - Installation microsoft .net 3.5 maintenance mode screen
CR34323   4th window                                                                CR34358   08.30: Unable to execute A3070toI5000.pl successfully
CR34324   08.30: Operator GUI :SpecialAux --> Set : File or directory not found     CR34359   08.30: PBD_after autodebug NPM execute to fail have internal error -11
CR34325   08.30: Special Aux connect feature implementation                         CR34360   TCM Account Starts in Program Monitor Mode
CR34326   08.20: add support for boundary-scan 1149.8.1 standard in ballot          CR34364   HVZ test is generated for ASRU-C config
          08.20: Unconnected test receiver does not capture data for differential   CR34365   08.30: PPU_Widget bar "stop" not function
CR34327   pairs                                                                     CR34366   08.30: Compile error of Actel STAPL file
          Allow CET for panel board with even no. of boards when CET Gnd wired                Improve IPG discharge with more conservative calculations for .discharge
CR34328   to XTP Gnd                                                                CR34384   file

                                                                                                                          Medalist In-Circuit Test 08.30p Software Release
                                                                                                                                                        Agilent Confidential
Page 8                                                                                                                                                           July 2012

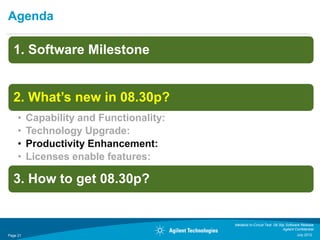

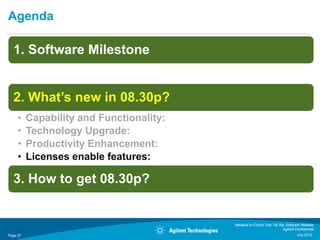

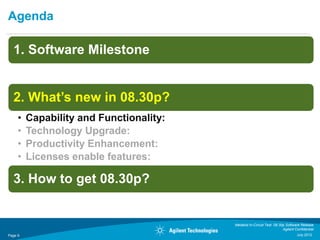

Agenda

  1. Software Milestone

  2. What’s new in 08.30p?
     •   Capability and Functionality:
     •   Technology Upgrade:
     •   Productivity Enhancement:
     •   Licenses enable features:

  3. How to get 08.30p?

                                         Medalist In-Circuit Test 08.30p Software Release
                                                                       Agilent Confidential
Page 9                                                                          July 2012
1. BT-Basic DLL integration feature Overview
Wrapper DLL is needed to export the standard APIs
  BTBasic_DLL_Call() for BT-Basic to call, and                         Functional
  redirects the call to 3rd party software
                                                                         Test

                                                                        Production
                           i3070             DLLs                       Mgmt SW

                                                                        Flash Prog
Ext_App_DLL feature license is needed to enable and
execute the following three new commands:

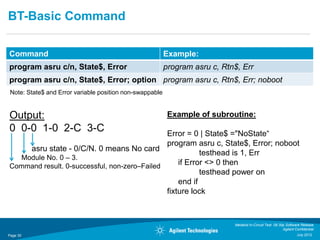

Commands & Syntax                                          Example:
dllload “<dll-name>”, <dll-handle>                         dllload “getboard_data.dll”, Handle_1
dllcall <dll-handle>, “<custom function name>”, [<return   dllcall Handle_1, “blank_check”,
number>], [“<return string>”]; [“<custom parameters>”]     Var_1, ErrMsg$; “0, 0xffff”
dllunload [<dll-handle>]                                   dllunload Handle_1

                                                                        Medalist In-Circuit Test 08.30p Software Release
                                                                                                      Agilent Confidential
Page 10                                                                                                        July 2012
Programming Model Overview

Generic flow of BTBasic executing dllcall, through the DLL wrapper to the DLL functions:
                                                                                           Customer’s DLLs
          BT-Basic                                          DLL wrapperA                                     Func DLL
   1.     …
          dllcall Handle_1, “blank_check”,       Calls      BTBasic_DLL_Call(“blank_check”, “0,      Calls   blank_check(0, 0xffff)
                  Var_1, ErrMsg$; “0, 0xffff”                              0xffff”, ErrMsg, Var_1)
          …

          BT-Basic
                                                                                               Customer’s DLLs
                                                               DLL wrapperB

   2.     dllload(“UtilWrapper.dll”, Handle_1)
          …
                                                    Calls
                                                               BTBasic_DLL_Call(“DoSimfunc1”,
                                                                              “100”, ErrMsg,
          dllcall Handle_1, “DoSimFun1”,

                                                                       Calls
                  Var_1, ErrMsg$; “100”                                       Var_1)
          …
                                                               DoFun1(int nCount)
                                                               { // perform some algorithm }

          BT-Basic                                                                             Customer’s DLLs
  3.      dllload(“UtilWrapper.dll”,
                                                                DLL wrapperC

                  Handle_1)                                     BTBasic_DLL_Call(“DoSimfunc
          …                                                                  1”, “100”,
                                                                       Calls

          dllcall Handle_1, “DoSimFun1”,                                     ErrMsg, Var_1)
                 Var_1, ErrMsg$; “100”
          …                                                     DoFun1(int nCount)
                                                                {
          dllcall Handle_1, “ExDllFunc1”,                       // perform some algorithm}
                  Var_1, ErrMsg$; “0,                           …                                            UtilDLL
                  0xffff”                                       BTBasic_DLL_Call(“ExDllFunc          Calls
                                                                                 1”, “0, 0xffff””,           ExDllFunc1(0,
          dllunload(Handle_1)                                                    ErrMsg, Var_1)              0xffff)

                                                                                                                    Medalist In-Circuit Test 08.30p Software Release
                                                                                                                                                  Agilent Confidential
Page 11                                                                                                                                                    July 2012
External DLL call (Sample)
  Specification:

  1. User Wrapper DLL – Must be C++
  2. Ext_App_DLL feature license needed during runtime

 Default:
 • example:
 dllload “Demo.dll”, Handle                     Example:
                                                - Custom function Sum() in the Sample.DLL
 Then, Software search the DLL at               - In BT-Basic, enter dllcall Dll-handle “Sum”, RetrunNum,
 Agilent_ICText_dev                            ReturnString$; “10,20,30”

                                                - BT-Basic will call the function BTBasic_DLL_Call() with
 User specify full path                         functionName “Sum” and parameters “10,20,30”.
 • example:
                                                - The parameters string “10,20,30” is converted into integer
 dllload
                                                array and passed to function Sum().
 “Agilent_ICTboardsdemoDemo.dll”,            - The Sum() calculate the sum of the elements of the integer
 Handle                                         array, and return back the result to caller.

 Then, software search the DLL at               - The value of ReturnNum will be 60 and the content of
 Agilent_ICTboardsdemo                        ReturnString$ will be "Function "Sum" has been called!"

                                                                                Medalist In-Circuit Test 08.30p Software Release
                                                                                                              Agilent Confidential
Page 12                                                                                                                July 2012
BT Basic - External DLL (Demonstration)

1. Demo.dll – updating Pass/Fail status of
   the DUT to the “demo.mdb” database.
2. The testplan_demo is updating test
   status for board with SN „0001‟ and
   ‟0002‟ .
3. Initial test status in database, „0001‟
   and „0002‟ are passed.
4. Assumed „0001‟ Pass and „0002‟ Fail.
5. Getting the status of S/N 0001 from
   database and update the result .
6. Getting the status of S/N 0002 and
   update accordingly.
7. SN0002 updated as FAIL.
8. Finally, the testplan unload the DLL
   from memory.

                                             Medalist In-Circuit Test 08.30p Software Release
                                                                           Agilent Confidential
Page 13                                                                             July 2012
2. Agilent i3070 LED Test solution

          Cost effective LED test at ICT.
           An industry FIRST! An Agilent innovation using proprietary architecture to
            measure LEDs with blazing speed – fastest in the industry.
           Accurate and repeatable color and intensity measurements ensures
            consistently reliable results.
           Fastest analysis speed saves time and money.
           Highest signal-to-noise performance enables you to test the widest range of
            LEDs.
                    i3070 LED Test Box    OR           i3070 LED Test Card

                                                                             N1807A Utility Card
                                                                     Medalist In-Circuit Test 08.30p Software Release
                                                                                                   Agilent Confidential
Page 14                                                                                                     July 2012
Agilent i3070 LED Test solution

          Fast, accurate, flexible and repeatable.
          • Proprietary architecture will send digital stimuli, measure the LEDs‟ color and
            intensity and returning results of up to 128 LEDs in less than 1.3 seconds.
          • Acquires the peak, base or instantaneous wavelengths of the LED color and
            returning the measurement in nanometers (nm).
          • Measures the LED intensity(luminosity) in μW`/cm2
          • Uncompromising repeatability achieved through a shroud tube design to shield
            noise (ambient light) from surrounding LEDs.

            Throughput
            Up to 128 LED sensors in 1.3s

                                                                      Medalist In-Circuit Test 08.30p Software Release
                                                                                                    Agilent Confidential
Page 15                                                                                                      July 2012
Agilent i3070 LED Test solution

            Release 8.3

                                  Medalist In-Circuit Test 08.30p Software Release
                                                                Agilent Confidential
Page 16                                                                  July 2012
Agenda

  1. Software Milestone

  2. What’s new in 08.30p?
     •    Capability and Functionality:
     •    Technology Upgrade:
     •    Productivity Enhancement:
     •    Licenses enable features:

  3. How to get 08.30p?

                                          Medalist In-Circuit Test 08.30p Software Release
                                                                        Agilent Confidential
Page 17                                                                          July 2012

1. RP5800 PC
             Rp5700                RP5800
             Microsoft Vista32B
Operating    Downgrade to XP32B OS Microsoft Windows 7 Pro
System       or                    32B
             Windows 7 Pro 32B
             Intel® Dual-Core      Intel® Core™ i5-2400
             Processor E2160 (1.80 (3.10 GHz, 6 MB cache,
Processor
             GHz, 1 MB L2 cache,   4 cores)
             800 MHz FSB)
             HP 2GB PC2-5300       4GB PC3-1333MHz
Memory       (DDR2-667) Memory - 4 DDR3 SDRAM (Max
             DIMM Slot             16GB)
             Integrated Intel Graphics Integrated Intel HD
Graphic
             Media Accelerator 3000                           Part number   Description

                                      250GB
Hard Drive   160GB SATA 3.0GB/s                               0960-3030     rp5800 with Windows 7 OS without
                                      SATA (7200 rpm)
                                                                            ICT Software
                                      SATA SuperMulti DVD
DVD          16X SATA DVD-Writer
                                      writer
                                      Integrated Intel
             Broadcom NetXtreme       82579LM
Network
             Gigabit PCI-E Adapter    Intel PRO 1000 CT GbE
                                      (optional)
                                      7 USB 2.0
             2 Rs232 ; 6 USB ; 1
Ports                                 1 24V powered USB
             parallel
                                      2 RS-232
                                                                                    Medalist In-Circuit Test 08.30p Software Release
                                                                                                                  Agilent Confidential
Page 18                                                                                                                    July 2012

rp5800 Vs rp5700 Test Time

                                      Windows 7   Rp5700       rp5800
                        Test Type                   sec          sec
          Preshorts                                    0.248        0.269
          Shorts                                       0.250        0.246
          Unpowered Analog                             0.251        0.248   LOAD BOARD Time
          Vectorless Test                              0.467        0.465   (Across Network)
          Polarity Test                                0.127        0.141
          PS Setup                                     0.447        0.454   LAN Card   RP5700                RP5800
          BScan Powered Shorts                        25.133       25.134   Setting    (08.21p)              (08.21p)
          BScan Interconnect                           0.193        0.198
          BScan Incircuit                              4.871        4.879
                                                                            Auto       4.2086 sec            2.75625 sec
          Bscan Silicon Nails                          0.033        0.044   (100M)
          Cover Extend                                 0.598        0.409
          Flash ID                                     0.017        0.015
          Flash Erase                                 10.044       10.043
          Flash Blank                                  0.018        0.018
          Flash Program                                0.048        0.046
          Flash Verify                                 0.040        0.038
          Flash CRC                                    0.162        0.161
          CPLD                                         6.338        6.335
          Total Digital Test                          16.793       16.783
          Analog Functional (Mixed)                    0.053        0.055
                                Total Test Time     66.131       65.981

                                                                                           Medalist In-Circuit Test 08.30p Software Release
                                                                                                                         Agilent Confidential
Page 19                                                                                                                           July 2012

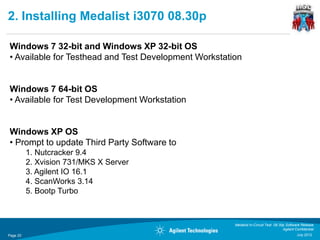

2. Installing Medalist i3070 08.30p

Windows 7 32-bit and Windows XP 32-bit OS
• Available for Testhead and Test Development Workstation

Windows 7 64-bit OS
• Available for Test Development Workstation

Windows XP OS
• Prompt to update Third Party Software to
          1. Nutcracker 9.4
          2. Xvision 731/MKS X Server
          3. Agilent IO 16.1
          4. ScanWorks 3.14
          5. Bootp Turbo

                                                       Medalist In-Circuit Test 08.30p Software Release
                                                                                     Agilent Confidential
Page 20                                                                                       July 2012
Agenda

  1. Software Milestone

  2. What’s new in 08.30p?
     •    Capability and Functionality:
     •    Technology Upgrade:
     •    Productivity Enhancement:
     •    Licenses enable features:

  3. How to get 08.30p?

                                          Medalist In-Circuit Test 08.30p Software Release
                                                                        Agilent Confidential
Page 21                                                                          July 2012

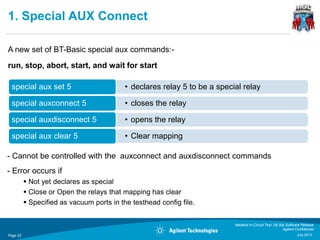

1. Special AUX Connect

A new set of BT-Basic special aux commands:-
run, stop, abort, start, and wait for start

 special aux set 5                         • declares relay 5 to be a special relay

 special auxconnect 5                      • closes the relay

 special auxdisconnect 5                   • opens the relay

 special aux clear 5                       • Clear mapping

- Cannot be controlled with the auxconnect and auxdisconnect commands
- Error occurs if
           Not yet declares as special
           Close or Open the relays that mapping has clear
           Specified as vacuum ports in the testhead config file.

                                                                           Medalist In-Circuit Test 08.30p Software Release
                                                                                                         Agilent Confidential
Page 22                                                                                                           July 2012

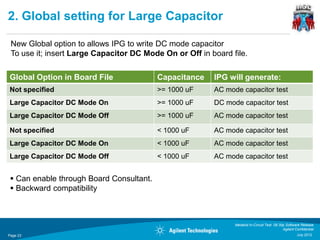

2. Global setting for Large Capacitor

 New Global option to allows IPG to write DC mode capacitor
 To use it; insert Large Capacitor DC Mode On or Off in board file.

Global Option in Board File               Capacitance    IPG will generate:
Not specified                             >= 1000 uF     AC mode capacitor test
Large Capacitor DC Mode On                >= 1000 uF     DC mode capacitor test
Large Capacitor DC Mode Off               >= 1000 uF     AC mode capacitor test

Not specified                             < 1000 uF      AC mode capacitor test
Large Capacitor DC Mode On                < 1000 uF      AC mode capacitor test
Large Capacitor DC Mode Off               < 1000 uF      AC mode capacitor test

  Can enable through Board Consultant.
  Backward compatibility

                                                               Medalist In-Circuit Test 08.30p Software Release
                                                                                             Agilent Confidential
Page 23                                                                                               July 2012
3. Discharge algorithm Enhancement

 Software Rev   Enhancement                         Remark
 08.20p         Entry Voltage <= 2v for discharge
 08.30p         Improve IPG discharge with more     APG_DISCHARGE_ROBUST = False
                                                    (conservative) – Default for 08.30p and later
                conservative calculations for       APG_DISCHARGE_ROBUST = True (actual)
                .discharge file                     For 08.20p or earlier

                                                                 Medalist In-Circuit Test 08.30p Software Release
                                                                                               Agilent Confidential
Page 24                                                                                                 July 2012

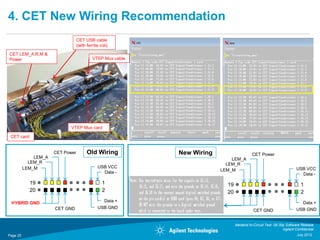

4. CET New Wiring Recommendation
                                  CET USB cable
                                  (with ferrite coil)
CET LEM_A,R,M &
Power                                      VTEP Mux cable

                             VTEP Mux card

 CET card

                      CET Power         Old Wiring          New Wiring                    CET Power
              LEM_A                                                          LEM_A
            LEM_R                                                          LEM_R
          LEM_M                                USB VCC                                                                 USB VCC
                                                 Data -                  LEM_M
                                                                                                                         Data -

            19                                   1                         19                                            1
            20                                   2                         20                                            2
 HYBRID GND                                        Data +                                                                  Data +
                      CET GND                  USB GND                                                                 USB GND
                                                                                           CET GND

                                                                                Medalist In-Circuit Test 08.30p Software Release
                                                                                                              Agilent Confidential
Page 25                                                                                                                July 2012

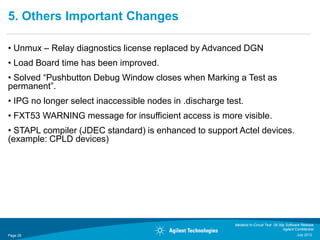

5. Others Important Changes

• Unmux – Relay diagnostics license replaced by Advanced DGN
• Load Board time has been improved.
• Solved “Pushbutton Debug Window closes when Marking a Test as
permanent”.
• IPG no longer select inaccessible nodes in .discharge test.
• FXT53 WARNING message for insufficient access is more visible.
• STAPL compiler (JDEC standard) is enhanced to support Actel devices.
(example: CPLD devices)

                                                          Medalist In-Circuit Test 08.30p Software Release
                                                                                        Agilent Confidential
Page 26                                                                                          July 2012
Agenda

  1. Software Milestone

  2. What’s new in 08.30p?
     •    Capability and Functionality:
     •    Technology Upgrade:
     •    Productivity Enhancement:
     •    Licenses enable features:

  3. How to get 08.30p?

                                          Medalist In-Circuit Test 08.30p Software Release
                                                                        Agilent Confidential
Page 27                                                                          July 2012

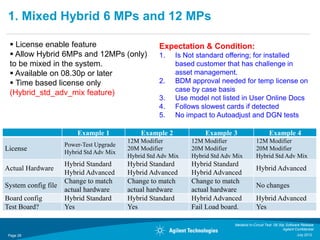

1. Mixed Hybrid 6 MPs and 12 MPs

  License enable feature                            Expectation & Condition:
  Allow Hybrid 6MPs and 12MPs (only)                1.   Is Not standard offering; for installed
 to be mixed in the system.                               based customer that has challenge in
  Available on 08.30p or later                           asset management.
  Time based license only                           2.   BDM approval needed for temp license on
 (Hybrid_std_adv_mix feature)                             case by case basis
                                                     3.   Use model not listed in User Online Docs
                                                     4.   Follows slowest cards if detected
                                                     5.   No impact to Autoadjust and DGN tests

                         Example 1            Example 2            Example 3                       Example 4
                                          12M Modifier         12M Modifier                12M Modifier
                     Power-Test Upgrade
License              Hybrid Std Adv Mix
                                          20M Modifier         20M Modifier                20M Modifier
                                          Hybrid Std Adv Mix   Hybrid Std Adv Mix          Hybrid Std Adv Mix
                     Hybrid Standard      Hybrid Standard      Hybrid Standard
Actual Hardware                                                                            Hybrid Advanced
                     Hybrid Advanced      Hybrid Advanced      Hybrid Advanced
                     Change to match      Change to match      Change to match
System config file                                                                         No changes
                     actual hardware      actual hardware      actual hardware
Board config         Hybrid Standard      Hybrid Standard      Hybrid Advanced             Hybrid Advanced
Test Board?          Yes                  Yes                  Fail Load board.            Yes

                                                                              Medalist In-Circuit Test 08.30p Software Release
                                                                                                            Agilent Confidential
 Page 28                                                                                                             July 2012
2. Enable ASRU N as ASRU C for Unix

 BT-Basic commands to enable the       Condition & Expectation:
ASRU N card to function as Rev “C” in   1.   Is Not standard offering; is targeted for
Unix or Rev “N” in Windows                   Dual Boot environment
                                        2.   BDM approval needed for temp license on
 Available on 08.30p or later
                                             case by case basis
 Time based license only               3.   DGN failures expected in Rev “C”. No fix is
                                             required.
                                        4.   No software support in Rev “C” (Unix)
                                        5.   Use model not listed in User Online Docs
                                        6.   NIST/ASRU cal must be done in ASRU Rev
                                             “N”. No support for Rev “C”.
                                        7.   No issue for Autoadjust in Rev “C”

Unix
Controller
                                                               Medalist In-Circuit Test 08.30p Software Release
                                                                                             Agilent Confidential
Page 29                                                                                               July 2012
BT-Basic Command

Command                                                   Example:
program asru c/n, State$, Error                           program asru c, Rtn$, Err
program asru c/n, State$, Error; option program asru c, Rtn$, Err; noboot
 Note: State$ and Error variable position non-swappable

Output:                                                    Example of subroutine:
0 0-0 1-0 2-C 3-C                             Error = 0 | State$ ="NoState“
                                              program asru c, State$, Error; noboot
    asru state - 0/C/N. 0 means No card
                                                         testhead is 1, Err
  Module No. 0 – 3.
Command result. 0-successful, non-zero–Failed     if Error <> 0 then
                                                         testhead power on
                                                  end if
                                              fixture lock

                                                                             Medalist In-Circuit Test 08.30p Software Release
                                                                                                           Agilent Confidential
Page 30                                                                                                             July 2012

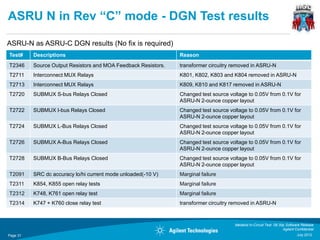

ASRU N in Rev “C” mode - DGN Test results

ASRU-N as ASRU-C DGN results (No fix is required)
Test#     Descriptions                                          Reason
T2346     Source Output Resistors and MOA Feedback Resistors.   transformer circuitry removed in ASRU-N
T2711     Interconnect MUX Relays                               K801, K802, K803 and K804 removed in ASRU-N
T2713     Interconnect MUX Relays                               K809, K810 and K817 removed in ASRU-N
T2720     SUBMUX S-bus Relays Closed                            Changed test source voltage to 0.05V from 0.1V for
                                                                ASRU-N 2-ounce copper layout
T2722     SUBMUX I-bus Relays Closed                            Changed test source voltage to 0.05V from 0.1V for
                                                                ASRU-N 2-ounce copper layout
T2724     SUBMUX L-Bus Relays Closed                            Changed test source voltage to 0.05V from 0.1V for
                                                                ASRU-N 2-ounce copper layout
T2726     SUBMUX A-Bus Relays Closed                            Changed test source voltage to 0.05V from 0.1V for
                                                                ASRU-N 2-ounce copper layout
T2728     SUBMUX B-Bus Relays Closed                            Changed test source voltage to 0.05V from 0.1V for
                                                                ASRU-N 2-ounce copper layout
T2091     SRC dc accuracy lo/hi current mode unloaded(-10 V)    Marginal failure
T2311     K854, K855 open relay tests                           Marginal failure
T2312     K748, K761 open relay test                            Marginal failure
T2314     K747 + K760 close relay test                          transformer circuitry removed in ASRU-N

                                                                                      Medalist In-Circuit Test 08.30p Software Release
                                                                                                                    Agilent Confidential
Page 31                                                                                                                      July 2012

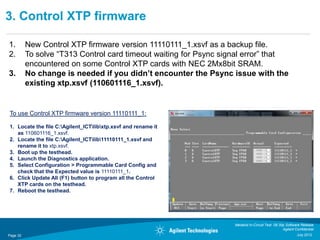

3. Control XTP firmware

1.        New Control XTP firmware version 11110111_1.xsvf as a backup file.
2.        To solve “T313 Control card timeout waiting for Psync signal error” that
          encountered on some Control XTP cards with NEC 2Mx8bit SRAM.
3.        No change is needed if you didn’t encounter the Psync issue with the
          existing xtp.xsvf (110601116_1.xsvf).

To use Control XTP firmware version 11110111_1:

1. Locate the file C:Agilent_ICTlibxtp.xsvf and rename it
   as 110601116_1.xsvf.
2. Locate the file C:Agilent_ICTlib11110111_1.xsvf and
   rename it to xtp.xsvf.
3. Boot up the testhead.
4. Launch the Diagnostics application.
5. Select Configuration > Programmable Card Config and
   check that the Expected value is 11110111_1.
6. Click Update All (F1) button to program all the Control
   XTP cards on the testhead.
7. Reboot the testhead.

                                                                   Medalist In-Circuit Test 08.30p Software Release
                                                                                                 Agilent Confidential
Page 32                                                                                                   July 2012
Agenda

   1. Software Milestone

   2. What’s new in 08.30p?

   3. How to get 08.30p?
     • Access to Software and Licenses
     • Redeem License
                                    Medalist In-Circuit Test 08.30p Software Release
                                                                  Agilent Confidential
Page 33                                                                    July 2012

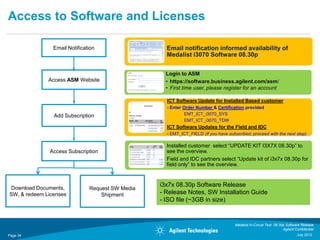

Access to Software and Licenses

                Email Notification                  Email notification informed availability of
                                                    Medalist i3070 Software 08.30p

                                                    Login to ASM
              Access ASM Website                    • https://software.business.agilent.com/asm/
                                                    • First time user, please register for an account

                                                    ICT Software Update for Installed Based customer
                                                    - Enter Order Number & Certification provided
                Add Subscription                             EMT_ICT_i3070_SYS
                                                             EMT_ICT_i3070_TDW
                                                    ICT Software Updates for the Field and IDC
                                                    - EMT_ICT_FIELD (if you have subscribed, proceed with the next step)

                                                    Installed customer select “UPDATE KIT I3X7X 08.30p” to
              Access Subscription                   see the overview.
                                                    Field and IDC partners select “Update kit of i3x7x 08.30p for
                                                    field only” to see the overview.

Download Documents,
                                                  i3x7x 08.30p Software Release
                               Request SW Media
SW, & redeem Licenses              Shipment       - Release Notes, SW Installation Guide
                                                  - ISO file (~3GB in size)

                                                                                     Medalist In-Circuit Test 08.30p Software Release
                                                                                                                   Agilent Confidential
Page 34                                                                                                                     July 2012
Redeem Ext_App_DLL feature license

- An added value feature for 08.30p software release.
- Distributed to user as FOC with testhead SUS only.

                                 1. Get License assign Mac address

                                 2. Specify your email address

                                 3. License file will be emailed
                                    immediately

                                                    Medalist In-Circuit Test 08.30p Software Release
                                                                                  Agilent Confidential
Page 35                                                                                    July 2012

Medalist i3070 08.30p software release

  • 1.
    Medalist i3070 08.30p Software Release Medalist In-Circuit Test 08.30p Software Release Agilent Confidential Page 1 July 2012
  • 2.
    Agenda 1. Software Milestone 2. What’s new in 08.30p? 3. How to get 08.30p? Medalist In-Circuit Test 08.30p Software Release Agilent Confidential Page 2 July 2012
  • 3.
    Agenda 1. Software Milestone • Software Release Milestone • Change Request List 2. What’s new in 08.30p? 3. How to get 08.30p? Medalist In-Circuit Test 08.30p Software Release Agilent Confidential Page 3 July 2012
  • 4.
    Medalist i3070 SoftwareRelease Milestone 2009 2010 2011 2012 2013 Continuous Improvement & Innovations Oct Jul Feb Nov Aug April* 08.00p SW 08.10p 08.20p 08.21p 08.30p SW 08.40p SW Utility Cards i3070 SW SW (XP & Win7) (XP & Win7) (XP & Win7) & ASRU N and Aug i3070 Agilent LED Test Current Product Engineering (CPE) S5 Nov Win 7 New Features 08.20p 08.21p 08.30p High-Power (N5747) Power Supply    High Voltage Zener    Windows 7 (32 bits)   Windows 7 (64 bits*)  LED Test  External DLL call  rp5800 PC  135 Change Request  Ship - 1 Aug 2012.  Field distribution - 1 Aug 2012 * Subject to change  SUS distribution - 17 Sep 2012 Medalist In-Circuit Test 08.30p Software Release Agilent Confidential Page 4 July 2012
  • 5.
    Appendix: Change RequestList - 1 CR ID Title CR ID Title CR27877 Unable to compile analog cluster (magic test) at PBD CR34143 quick report doesn't find all tests CR29362 07.00pf: Board Consultant: Range for Tolerance Multiplier Is Incorrect CR34150 ASRU N diagnostics failure 2824 CR33453 i3070 : ERROR!! result from Browser Locator Find Probe action CR34152 08.20a: Support Info closes automatically i3070: Controllerloop causes measurement timeout in analog portion of CR34154 Alternate PC portable based dongle pin card programming CR33602 mixed test CR34156 To remove MIL-STD-45662A wording from NIST CAL testplan i3070SW: Panel testplan subroutine Program_Flash does not declare CR34159 08.20p "load board" command takes longer time to finish CR33604 variables True CR34162 3070SW: icap card: fixture auto- unlocked during reboot. 08.10: Support Info-Readme Under Control Panel For Agilent IO 15.5 not CR34163 Add lost heart beat message and time stamp in pmlog CR33842 working Data polling in flash isp test does not work with xtp firmware version CR33922 08.10: CA: Tested in parallel incorrect coverage count CR34165 10071517 CR33962 Digital setup editor would shutdown CR34166 enhance ASRU cal 4395 and 4396 to write and check tracking feature CR33990 customer requests an ability to call DLL command libraries CR34167 i3070: Enh Req to inhibit auto-converting to Multiple Board Versions CR34045 08.20:Engineer GUI, More then one "GL" boxes can be checked i3070 8.20p: need to select FPY/WPR view each time Operator GUI is CR34048 program memory exceeded CR34170 launched CR34080 08.20 DGN Display Failure issue DC capacitor test causing subsequent test with "ed" option failed or CR34085 08.20 : Browser : Personality Pins cannot browse CR34175 timeout CR34090 parse board and board_xy for conflicts when loading in operator GUI CR34177 NPM Issue encounterred in 08.20p CR34099 Get statement automatically writes name in the title bar of BT-Basic CR34179 08.20: ASRU N Diagnostic Failure T2824 - Improve yield CR34100 Automated display backslashes as slashes in BT-Basic Title CR34180 08.20p: Wrong Error message for ASRU Calibration CR34111 preferences setting in the board directory and User home directory CR34181 Pushbutton Debug Window closes when Marking a Test as permanent. CR34116 To enable ASRU N to work under UNIX as ASRU C / D 08.20b: By default, FPY and WPR should be tick check after operator GUI CR34119 Should auto check "En" option if sense "A" is used CR34182 start CR34126 08:20 Agilent Coverage Analyst got wrong Revision CR34183 08.20b: No revision info display in i3070 Medalist CR34127 08.20: TTFXT_HP6621 compile config failed 08.20b: Installed Window Service for Unix cause issue in control of 08.20: Engineer GUI : Incorrect message for ar value of less than 18 for CR34185 testhead CR34133 HVZ 08.20: CA: BScan,CE and SN not reported as Test Technique used in symlink & iNode not working in TTDB GUI Panel test strategy when using CR34190 Executive Sum CR34136 NFS CR34191 Coverage Analyst not handling Preshorts and Powered Analog correctly 08.20p: HVZ_TTDB mark permanent or commented cause prepowered NIST Calibration Testplan uses Wrong Units for Temperature in Report CR34139 erase in testorder CR34192 Header CR34142 digital test reports error from AUX which is not used CR34200 i3070 8.x: BT-Basic Internal Error -13 at 'select boards on panel' Relay Locator Diagram for unmux hybrid shows incorrect reference CR34204 designators Medalist In-Circuit Test 08.30p Software Release Agilent Confidential Page 6 July 2012
  • 6.
    Appendix: Change RequestList - 2 CR ID Title CR ID Title CR34208 Xvision Install error if i3070 sw is removed and re-installed 0820p Mixed Test failing line numbers and calling sequence not displayed in 08.20p: BSDL parser does not flag single-ended, differential pins as CR34249 PBDebug CR34209 errors CR34252 i3070 8.00p: Unility Card mux power supply wiring failed CR34214 4 Languages Software License Term 08.20: CA: Panel : Wrong report:tested devices reported as untested & Making Diagnose Relay licensing requirement same for Mux and CR34254 vice versa CR34215 Unmux CR34258 i3070: ConnectCheck learned value not save in PBDebug 3070: The BSDL compiler does not issue a warning for part 4 of rule CR34259 08.20e: PBD : Internal Error -11 opening a digital test CR34216 B.8.18.4u). 08.20e:UnMUX:T342 Control 3 Real Math Error running the Analog_Tests CR34218 08.30: Default xtp.xsvf file is 02020812_1 instead of 11060116_1 CR34260 subroutine 08.30: Installation: Missing link (file) to Medalist i3070 software install 08.20pe: Angela board; Bt Basic encounter internal error when call CR34219 help CR34262 Analog_Test 08.30: DGN new Test 8 (cal date & stored data) implemented on CR34263 i3070: Actel STAPL not compatible with 3070 PLD ISP CR34220 Unmux CR34265 extra line of 'sequencer halted' in digital failure message CR34221 08.30 : DGN : Request to identify module # for T4396 CR34266 08.20e : vcllib.exe error during lib compile 08.30 : Expired cal: Calibration Message for testh is 1 is incorrect & CR34268 IPG select inaccessible nodes in .discharge test CR34223 clearable CR34269 i3070: ICT Browser and Engineer GUI "Error in File Type: board" CR34224 08.30:No Program_pin_card lic "Program Cards" is still enabled in DGN CR34270 breaking recycle to fail for polarity test causes Pascal system error 8 CR34227 i3070: ENH REQ Board Consultant should display more than 5 boards CR34271 Display Graphics menu is grey out for Polarity test in Pushbutton debug i3070 8.x: ENH REQ board setting for IPG to write AC cap test or DC cap CR34276 08.30 Uninstall, SCO Vision hang during uninstall CR34228 test CR34277 08.30p Engineer Gui AIC Left Table duplicate column for CPK i3070: ENH REQ FXT53 WARNING message much obvious for CR34278 08.30p Installation,AgilentIO encounter error 1722 if use fresh WinXP HD CR34229 insufficient access CR34279 Need the maximum Instruction Register length to be increased CR34230 08.20: Hang on xvision uninstallation of 08.20p CR34281 08.30p Engineer GUI - Missing Permanent column in AIC Left Table CR34231 With rev 0820p it's not possible to open Setup Editor 08.30p Testh power off - Failure in Medalist operator gui and Btbasic CR34236 i3070 8.x: Conversion Tool needs updating for 8.x software CR34282 window 08.30:Oper GUI: Implement saved setting to show/hide FPY/WPR on CR34288 08.30 BtBasic, GPIB timeout when do 'testhead is 1' CR34237 Chinese locale CR34290 Coverage Analyst hangs at Binding Test and Board Data CR34239 i3070 08.xx: Improve file checking efficience over network 08.30 Wrong Control XTP seq FPGA version, expected version is CR34240 I3070HW: Nasru Cards are reporting 3374/3376 Errors. CR34291 11060116_1 Testplan statements itb$ and num cause missing characters on display CR34292 3070 GUI hangup on 2lvl fn calls CR34248 and in logs Medalist In-Circuit Test 08.30p Software Release Agilent Confidential Page 7 July 2012
  • 7.
    Appendix: Change RequestList - 3 CR ID Title CR ID Title CR34293 Stapl compiler does not parse arithmetic assignment properly CR34329 Recommend new kind of wiring for CET Card to prevent CET burnout CR34294 N6751A DUT power supply fail DGN Test number 2340-DPS ground fault CR34330 Support uVTEP with license control CR34295 08.30: Program Asru encounter software internal error CR34334 08.30: Outdated Agilent copyright year info CR34297 8.30p IPG Test Consultant GUI -Selected Directory Contents issue CR34336 08.30: ASRU N Diagnostic Failure T2283 - Improve yield CR34301 Timer functions to capture test time at board or sub-test level CR34337 Enhanced 6M 12M hybrid mixable in testhead CR34305 Needs auxconnect that does not release when press STOP CR34338 08.30: To add an error variable parameter for external dll commands CR34306 Histogram failed to generate on failing tests (i3070 Medalist) 08.30p IPG TestConsultant - Run Test Cell Manager window caption CR34308 Quick Report does not report new hardware CR34339 wrong CR34311 Enable back ps6751 CR34340 08.30p BtBasic caption missing "" CR34312 Control XTP Psync Error CR34346 Boolean array assignment and syntax error line number display CR34318 Browser cannot display a panelized board in Bank 1 CR34348 08.30: Q-Stats report Histogram type encounter hang CR34319 08.30: Cannot launch BScan Chain Viewer CR34321 08:30: Testhead cannot boot successfully in RP5800 controller CR34349 08.30: PBD_Edit menu execute Copy and Paste failed and cause GUI hang CR34322 Incorrect .discharge file causes relay damage CR34350 08.30: PPU_without credit button still can load board and run ICT test debug end causes bt-basic hang when digital waveform window is the CR34357 08.30p - Installation microsoft .net 3.5 maintenance mode screen CR34323 4th window CR34358 08.30: Unable to execute A3070toI5000.pl successfully CR34324 08.30: Operator GUI :SpecialAux --> Set : File or directory not found CR34359 08.30: PBD_after autodebug NPM execute to fail have internal error -11 CR34325 08.30: Special Aux connect feature implementation CR34360 TCM Account Starts in Program Monitor Mode CR34326 08.20: add support for boundary-scan 1149.8.1 standard in ballot CR34364 HVZ test is generated for ASRU-C config 08.20: Unconnected test receiver does not capture data for differential CR34365 08.30: PPU_Widget bar "stop" not function CR34327 pairs CR34366 08.30: Compile error of Actel STAPL file Allow CET for panel board with even no. of boards when CET Gnd wired Improve IPG discharge with more conservative calculations for .discharge CR34328 to XTP Gnd CR34384 file Medalist In-Circuit Test 08.30p Software Release Agilent Confidential Page 8 July 2012
  • 8.
    Agenda 1.Software Milestone 2. What’s new in 08.30p? • Capability and Functionality: • Technology Upgrade: • Productivity Enhancement: • Licenses enable features: 3. How to get 08.30p? Medalist In-Circuit Test 08.30p Software Release Agilent Confidential Page 9 July 2012
  • 9.
    1. BT-Basic DLLintegration feature Overview Wrapper DLL is needed to export the standard APIs BTBasic_DLL_Call() for BT-Basic to call, and Functional redirects the call to 3rd party software Test Production i3070 DLLs Mgmt SW Flash Prog Ext_App_DLL feature license is needed to enable and execute the following three new commands: Commands & Syntax Example: dllload “<dll-name>”, <dll-handle> dllload “getboard_data.dll”, Handle_1 dllcall <dll-handle>, “<custom function name>”, [<return dllcall Handle_1, “blank_check”, number>], [“<return string>”]; [“<custom parameters>”] Var_1, ErrMsg$; “0, 0xffff” dllunload [<dll-handle>] dllunload Handle_1 Medalist In-Circuit Test 08.30p Software Release Agilent Confidential Page 10 July 2012
  • 10.
    Programming Model Overview Genericflow of BTBasic executing dllcall, through the DLL wrapper to the DLL functions: Customer’s DLLs BT-Basic DLL wrapperA Func DLL 1. … dllcall Handle_1, “blank_check”, Calls BTBasic_DLL_Call(“blank_check”, “0, Calls blank_check(0, 0xffff) Var_1, ErrMsg$; “0, 0xffff” 0xffff”, ErrMsg, Var_1) … BT-Basic Customer’s DLLs DLL wrapperB 2. dllload(“UtilWrapper.dll”, Handle_1) … Calls BTBasic_DLL_Call(“DoSimfunc1”, “100”, ErrMsg, dllcall Handle_1, “DoSimFun1”, Calls Var_1, ErrMsg$; “100” Var_1) … DoFun1(int nCount) { // perform some algorithm } BT-Basic Customer’s DLLs 3. dllload(“UtilWrapper.dll”, DLL wrapperC Handle_1) BTBasic_DLL_Call(“DoSimfunc … 1”, “100”, Calls dllcall Handle_1, “DoSimFun1”, ErrMsg, Var_1) Var_1, ErrMsg$; “100” … DoFun1(int nCount) { dllcall Handle_1, “ExDllFunc1”, // perform some algorithm} Var_1, ErrMsg$; “0, … UtilDLL 0xffff” BTBasic_DLL_Call(“ExDllFunc Calls 1”, “0, 0xffff””, ExDllFunc1(0, dllunload(Handle_1) ErrMsg, Var_1) 0xffff) Medalist In-Circuit Test 08.30p Software Release Agilent Confidential Page 11 July 2012
  • 11.
    External DLL call(Sample) Specification: 1. User Wrapper DLL – Must be C++ 2. Ext_App_DLL feature license needed during runtime Default: • example: dllload “Demo.dll”, Handle Example: - Custom function Sum() in the Sample.DLL Then, Software search the DLL at - In BT-Basic, enter dllcall Dll-handle “Sum”, RetrunNum, Agilent_ICText_dev ReturnString$; “10,20,30” - BT-Basic will call the function BTBasic_DLL_Call() with User specify full path functionName “Sum” and parameters “10,20,30”. • example: - The parameters string “10,20,30” is converted into integer dllload array and passed to function Sum(). “Agilent_ICTboardsdemoDemo.dll”, - The Sum() calculate the sum of the elements of the integer Handle array, and return back the result to caller. Then, software search the DLL at - The value of ReturnNum will be 60 and the content of Agilent_ICTboardsdemo ReturnString$ will be "Function "Sum" has been called!" Medalist In-Circuit Test 08.30p Software Release Agilent Confidential Page 12 July 2012
  • 12.
    BT Basic -External DLL (Demonstration) 1. Demo.dll – updating Pass/Fail status of the DUT to the “demo.mdb” database. 2. The testplan_demo is updating test status for board with SN „0001‟ and ‟0002‟ . 3. Initial test status in database, „0001‟ and „0002‟ are passed. 4. Assumed „0001‟ Pass and „0002‟ Fail. 5. Getting the status of S/N 0001 from database and update the result . 6. Getting the status of S/N 0002 and update accordingly. 7. SN0002 updated as FAIL. 8. Finally, the testplan unload the DLL from memory. Medalist In-Circuit Test 08.30p Software Release Agilent Confidential Page 13 July 2012
  • 13.
    2. Agilent i3070LED Test solution Cost effective LED test at ICT.  An industry FIRST! An Agilent innovation using proprietary architecture to measure LEDs with blazing speed – fastest in the industry.  Accurate and repeatable color and intensity measurements ensures consistently reliable results.  Fastest analysis speed saves time and money.  Highest signal-to-noise performance enables you to test the widest range of LEDs. i3070 LED Test Box OR i3070 LED Test Card N1807A Utility Card Medalist In-Circuit Test 08.30p Software Release Agilent Confidential Page 14 July 2012
  • 14.
    Agilent i3070 LEDTest solution Fast, accurate, flexible and repeatable. • Proprietary architecture will send digital stimuli, measure the LEDs‟ color and intensity and returning results of up to 128 LEDs in less than 1.3 seconds. • Acquires the peak, base or instantaneous wavelengths of the LED color and returning the measurement in nanometers (nm). • Measures the LED intensity(luminosity) in μW`/cm2 • Uncompromising repeatability achieved through a shroud tube design to shield noise (ambient light) from surrounding LEDs. Throughput Up to 128 LED sensors in 1.3s Medalist In-Circuit Test 08.30p Software Release Agilent Confidential Page 15 July 2012
  • 15.
    Agilent i3070 LEDTest solution Release 8.3 Medalist In-Circuit Test 08.30p Software Release Agilent Confidential Page 16 July 2012
  • 16.
    Agenda 1.Software Milestone 2. What’s new in 08.30p? • Capability and Functionality: • Technology Upgrade: • Productivity Enhancement: • Licenses enable features: 3. How to get 08.30p? Medalist In-Circuit Test 08.30p Software Release Agilent Confidential Page 17 July 2012
  • 17.
    1. RP5800 PC Rp5700 RP5800 Microsoft Vista32B Operating Downgrade to XP32B OS Microsoft Windows 7 Pro System or 32B Windows 7 Pro 32B Intel® Dual-Core Intel® Core™ i5-2400 Processor E2160 (1.80 (3.10 GHz, 6 MB cache, Processor GHz, 1 MB L2 cache, 4 cores) 800 MHz FSB) HP 2GB PC2-5300 4GB PC3-1333MHz Memory (DDR2-667) Memory - 4 DDR3 SDRAM (Max DIMM Slot 16GB) Integrated Intel Graphics Integrated Intel HD Graphic Media Accelerator 3000 Part number Description 250GB Hard Drive 160GB SATA 3.0GB/s 0960-3030 rp5800 with Windows 7 OS without SATA (7200 rpm) ICT Software SATA SuperMulti DVD DVD 16X SATA DVD-Writer writer Integrated Intel Broadcom NetXtreme 82579LM Network Gigabit PCI-E Adapter Intel PRO 1000 CT GbE (optional) 7 USB 2.0 2 Rs232 ; 6 USB ; 1 Ports 1 24V powered USB parallel 2 RS-232 Medalist In-Circuit Test 08.30p Software Release Agilent Confidential Page 18 July 2012
  • 18.
    rp5800 Vs rp5700Test Time Windows 7 Rp5700 rp5800 Test Type sec sec Preshorts 0.248 0.269 Shorts 0.250 0.246 Unpowered Analog 0.251 0.248 LOAD BOARD Time Vectorless Test 0.467 0.465 (Across Network) Polarity Test 0.127 0.141 PS Setup 0.447 0.454 LAN Card RP5700 RP5800 BScan Powered Shorts 25.133 25.134 Setting (08.21p) (08.21p) BScan Interconnect 0.193 0.198 BScan Incircuit 4.871 4.879 Auto 4.2086 sec 2.75625 sec Bscan Silicon Nails 0.033 0.044 (100M) Cover Extend 0.598 0.409 Flash ID 0.017 0.015 Flash Erase 10.044 10.043 Flash Blank 0.018 0.018 Flash Program 0.048 0.046 Flash Verify 0.040 0.038 Flash CRC 0.162 0.161 CPLD 6.338 6.335 Total Digital Test 16.793 16.783 Analog Functional (Mixed) 0.053 0.055 Total Test Time 66.131 65.981 Medalist In-Circuit Test 08.30p Software Release Agilent Confidential Page 19 July 2012
  • 19.
    2. Installing Medalisti3070 08.30p Windows 7 32-bit and Windows XP 32-bit OS • Available for Testhead and Test Development Workstation Windows 7 64-bit OS • Available for Test Development Workstation Windows XP OS • Prompt to update Third Party Software to 1. Nutcracker 9.4 2. Xvision 731/MKS X Server 3. Agilent IO 16.1 4. ScanWorks 3.14 5. Bootp Turbo Medalist In-Circuit Test 08.30p Software Release Agilent Confidential Page 20 July 2012
  • 20.
    Agenda 1.Software Milestone 2. What’s new in 08.30p? • Capability and Functionality: • Technology Upgrade: • Productivity Enhancement: • Licenses enable features: 3. How to get 08.30p? Medalist In-Circuit Test 08.30p Software Release Agilent Confidential Page 21 July 2012
  • 21.
    1. Special AUXConnect A new set of BT-Basic special aux commands:- run, stop, abort, start, and wait for start special aux set 5 • declares relay 5 to be a special relay special auxconnect 5 • closes the relay special auxdisconnect 5 • opens the relay special aux clear 5 • Clear mapping - Cannot be controlled with the auxconnect and auxdisconnect commands - Error occurs if  Not yet declares as special  Close or Open the relays that mapping has clear  Specified as vacuum ports in the testhead config file. Medalist In-Circuit Test 08.30p Software Release Agilent Confidential Page 22 July 2012
  • 22.
    2. Global settingfor Large Capacitor New Global option to allows IPG to write DC mode capacitor To use it; insert Large Capacitor DC Mode On or Off in board file. Global Option in Board File Capacitance IPG will generate: Not specified >= 1000 uF AC mode capacitor test Large Capacitor DC Mode On >= 1000 uF DC mode capacitor test Large Capacitor DC Mode Off >= 1000 uF AC mode capacitor test Not specified < 1000 uF AC mode capacitor test Large Capacitor DC Mode On < 1000 uF AC mode capacitor test Large Capacitor DC Mode Off < 1000 uF AC mode capacitor test  Can enable through Board Consultant.  Backward compatibility Medalist In-Circuit Test 08.30p Software Release Agilent Confidential Page 23 July 2012
  • 23.
    3. Discharge algorithmEnhancement Software Rev Enhancement Remark 08.20p Entry Voltage <= 2v for discharge 08.30p Improve IPG discharge with more APG_DISCHARGE_ROBUST = False (conservative) – Default for 08.30p and later conservative calculations for APG_DISCHARGE_ROBUST = True (actual) .discharge file For 08.20p or earlier Medalist In-Circuit Test 08.30p Software Release Agilent Confidential Page 24 July 2012
  • 24.
    4. CET NewWiring Recommendation CET USB cable (with ferrite coil) CET LEM_A,R,M & Power VTEP Mux cable VTEP Mux card CET card CET Power Old Wiring New Wiring CET Power LEM_A LEM_A LEM_R LEM_R LEM_M USB VCC USB VCC Data - LEM_M Data - 19 1 19 1 20 2 20 2 HYBRID GND Data + Data + CET GND USB GND USB GND CET GND Medalist In-Circuit Test 08.30p Software Release Agilent Confidential Page 25 July 2012
  • 25.
    5. Others ImportantChanges • Unmux – Relay diagnostics license replaced by Advanced DGN • Load Board time has been improved. • Solved “Pushbutton Debug Window closes when Marking a Test as permanent”. • IPG no longer select inaccessible nodes in .discharge test. • FXT53 WARNING message for insufficient access is more visible. • STAPL compiler (JDEC standard) is enhanced to support Actel devices. (example: CPLD devices) Medalist In-Circuit Test 08.30p Software Release Agilent Confidential Page 26 July 2012
  • 26.
    Agenda 1.Software Milestone 2. What’s new in 08.30p? • Capability and Functionality: • Technology Upgrade: • Productivity Enhancement: • Licenses enable features: 3. How to get 08.30p? Medalist In-Circuit Test 08.30p Software Release Agilent Confidential Page 27 July 2012
  • 27.
    1. Mixed Hybrid6 MPs and 12 MPs  License enable feature Expectation & Condition:  Allow Hybrid 6MPs and 12MPs (only) 1. Is Not standard offering; for installed to be mixed in the system. based customer that has challenge in  Available on 08.30p or later asset management.  Time based license only 2. BDM approval needed for temp license on (Hybrid_std_adv_mix feature) case by case basis 3. Use model not listed in User Online Docs 4. Follows slowest cards if detected 5. No impact to Autoadjust and DGN tests Example 1 Example 2 Example 3 Example 4 12M Modifier 12M Modifier 12M Modifier Power-Test Upgrade License Hybrid Std Adv Mix 20M Modifier 20M Modifier 20M Modifier Hybrid Std Adv Mix Hybrid Std Adv Mix Hybrid Std Adv Mix Hybrid Standard Hybrid Standard Hybrid Standard Actual Hardware Hybrid Advanced Hybrid Advanced Hybrid Advanced Hybrid Advanced Change to match Change to match Change to match System config file No changes actual hardware actual hardware actual hardware Board config Hybrid Standard Hybrid Standard Hybrid Advanced Hybrid Advanced Test Board? Yes Yes Fail Load board. Yes Medalist In-Circuit Test 08.30p Software Release Agilent Confidential Page 28 July 2012
  • 28.
    2. Enable ASRUN as ASRU C for Unix  BT-Basic commands to enable the Condition & Expectation: ASRU N card to function as Rev “C” in 1. Is Not standard offering; is targeted for Unix or Rev “N” in Windows Dual Boot environment 2. BDM approval needed for temp license on  Available on 08.30p or later case by case basis  Time based license only 3. DGN failures expected in Rev “C”. No fix is required. 4. No software support in Rev “C” (Unix) 5. Use model not listed in User Online Docs 6. NIST/ASRU cal must be done in ASRU Rev “N”. No support for Rev “C”. 7. No issue for Autoadjust in Rev “C” Unix Controller Medalist In-Circuit Test 08.30p Software Release Agilent Confidential Page 29 July 2012
  • 29.
    BT-Basic Command Command Example: program asru c/n, State$, Error program asru c, Rtn$, Err program asru c/n, State$, Error; option program asru c, Rtn$, Err; noboot Note: State$ and Error variable position non-swappable Output: Example of subroutine: 0 0-0 1-0 2-C 3-C Error = 0 | State$ ="NoState“ program asru c, State$, Error; noboot asru state - 0/C/N. 0 means No card testhead is 1, Err Module No. 0 – 3. Command result. 0-successful, non-zero–Failed if Error <> 0 then testhead power on end if fixture lock Medalist In-Circuit Test 08.30p Software Release Agilent Confidential Page 30 July 2012
  • 30.
    ASRU N inRev “C” mode - DGN Test results ASRU-N as ASRU-C DGN results (No fix is required) Test# Descriptions Reason T2346 Source Output Resistors and MOA Feedback Resistors. transformer circuitry removed in ASRU-N T2711 Interconnect MUX Relays K801, K802, K803 and K804 removed in ASRU-N T2713 Interconnect MUX Relays K809, K810 and K817 removed in ASRU-N T2720 SUBMUX S-bus Relays Closed Changed test source voltage to 0.05V from 0.1V for ASRU-N 2-ounce copper layout T2722 SUBMUX I-bus Relays Closed Changed test source voltage to 0.05V from 0.1V for ASRU-N 2-ounce copper layout T2724 SUBMUX L-Bus Relays Closed Changed test source voltage to 0.05V from 0.1V for ASRU-N 2-ounce copper layout T2726 SUBMUX A-Bus Relays Closed Changed test source voltage to 0.05V from 0.1V for ASRU-N 2-ounce copper layout T2728 SUBMUX B-Bus Relays Closed Changed test source voltage to 0.05V from 0.1V for ASRU-N 2-ounce copper layout T2091 SRC dc accuracy lo/hi current mode unloaded(-10 V) Marginal failure T2311 K854, K855 open relay tests Marginal failure T2312 K748, K761 open relay test Marginal failure T2314 K747 + K760 close relay test transformer circuitry removed in ASRU-N Medalist In-Circuit Test 08.30p Software Release Agilent Confidential Page 31 July 2012
  • 31.
    3. Control XTPfirmware 1. New Control XTP firmware version 11110111_1.xsvf as a backup file. 2. To solve “T313 Control card timeout waiting for Psync signal error” that encountered on some Control XTP cards with NEC 2Mx8bit SRAM. 3. No change is needed if you didn’t encounter the Psync issue with the existing xtp.xsvf (110601116_1.xsvf). To use Control XTP firmware version 11110111_1: 1. Locate the file C:Agilent_ICTlibxtp.xsvf and rename it as 110601116_1.xsvf. 2. Locate the file C:Agilent_ICTlib11110111_1.xsvf and rename it to xtp.xsvf. 3. Boot up the testhead. 4. Launch the Diagnostics application. 5. Select Configuration > Programmable Card Config and check that the Expected value is 11110111_1. 6. Click Update All (F1) button to program all the Control XTP cards on the testhead. 7. Reboot the testhead. Medalist In-Circuit Test 08.30p Software Release Agilent Confidential Page 32 July 2012
  • 32.
    Agenda 1. Software Milestone 2. What’s new in 08.30p? 3. How to get 08.30p? • Access to Software and Licenses • Redeem License Medalist In-Circuit Test 08.30p Software Release Agilent Confidential Page 33 July 2012
  • 33.
    Access to Softwareand Licenses Email Notification Email notification informed availability of Medalist i3070 Software 08.30p Login to ASM Access ASM Website • https://software.business.agilent.com/asm/ • First time user, please register for an account ICT Software Update for Installed Based customer - Enter Order Number & Certification provided Add Subscription EMT_ICT_i3070_SYS EMT_ICT_i3070_TDW ICT Software Updates for the Field and IDC - EMT_ICT_FIELD (if you have subscribed, proceed with the next step) Installed customer select “UPDATE KIT I3X7X 08.30p” to Access Subscription see the overview. Field and IDC partners select “Update kit of i3x7x 08.30p for field only” to see the overview. Download Documents, i3x7x 08.30p Software Release Request SW Media SW, & redeem Licenses Shipment - Release Notes, SW Installation Guide - ISO file (~3GB in size) Medalist In-Circuit Test 08.30p Software Release Agilent Confidential Page 34 July 2012
  • 34.
    Redeem Ext_App_DLL featurelicense - An added value feature for 08.30p software release. - Distributed to user as FOC with testhead SUS only. 1. Get License assign Mac address 2. Specify your email address 3. License file will be emailed immediately Medalist In-Circuit Test 08.30p Software Release Agilent Confidential Page 35 July 2012
