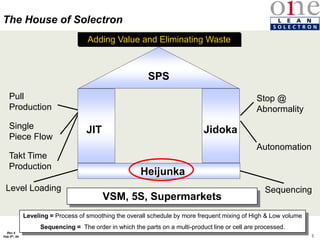

Solectron Production System
Six Sigma Lean
Lean Basics
Part II
Functional Excellence
Rev 4, February 5th 04
2
Rev 4
Feb 5th, 04
Stop @
Abnormality
Takt Time
Production
Single
Piece Flow
Pull
Production
Autonomation
Sequencing
Level Loading
JIT Jidoka
Heijunka

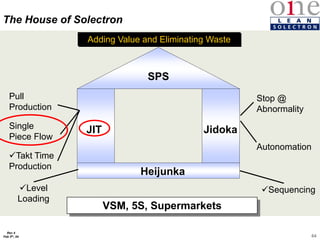

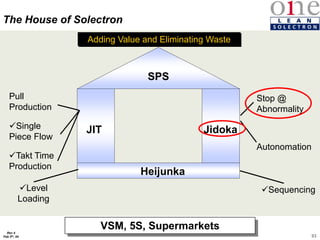

SPS

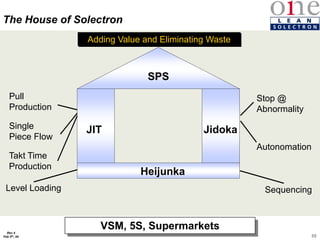

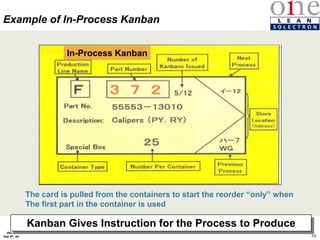

The House of Solectron
VSM, 5S, Supermarkets
Adding Value and Eliminating Waste
3
Rev 4
Feb 5th, 04

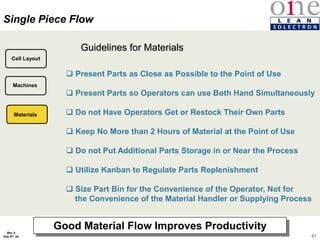

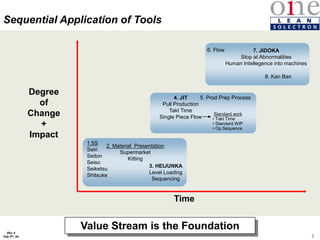

5. Prod Prep Process
4. JIT
Pull Production
Takt Time
Single Piece Flow • Takt Time
• Standard WIP
• Op Sequence
Standard work
8. Kan Ban
6. Flow 7. JIDOKA
Stop at Abnormalities
Human Intellegence into machines
1.5S
Seiri
Seiton
Seiso
Seiketsu
Shitsuke
2. Material Presentation
Supermarket
Kitting
3. HEIJUNKA
Level Loading
Sequencing
Time
Sequential Application of Tools
Degree
of
Change
+
Impact

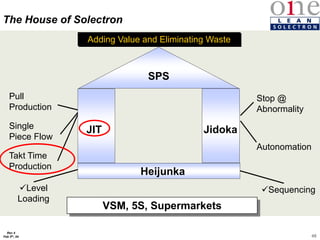

Value Stream is the Foundation
4
Rev 4
Feb 5th, 04
Heijunka
Level Loading Sequencing
5
Rev 4
Feb 5th, 04
Stop @
Abnormality
Takt Time
Production

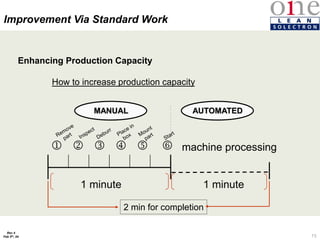

Single
Piece Flow
Pull
Production
Autonomation
Sequencing
Level Loading
JIT Jidoka
Heijunka
SPS
The House of Solectron
VSM, 5S, Supermarkets
Adding Value and Eliminating Waste
Leveling = Process of smoothing the overall schedule by more frequent mixing of High & Low volume
Sequencing = The order in which the parts on a multi-product line or cell are processed.
6
Rev 4
Feb 5th, 04
Customer Demand Leveled production
• How Can a Shop Resource This ?
• How Can the Supply Chain Cope ?
• What if the Supply Chain is Global ?
Heijunka is a Forcing Function
Heijunka
Heijunka
7
Rev 4
Feb 5th, 04

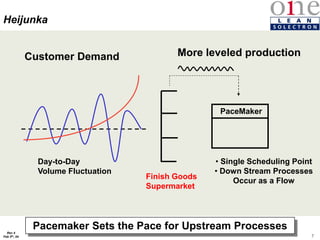

Customer Demand More leveled production
Heijunka
PaceMaker
Finish Goods
Supermarket
Day-to-Day
Volume Fluctuation
• Single Scheduling Point
• Down Stream Processes

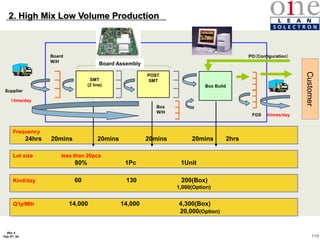

Occur as a Flow
Pacemaker Sets the Pace for Upstream Processes
8
Rev 4
Feb 5th, 04

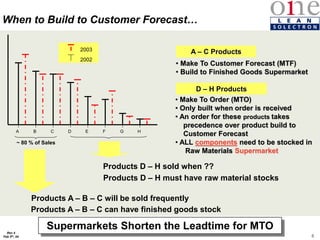

A B C D E F G H
2002
2003
~ 80 % of Sales
Products A – B – C will be sold frequently
Products A – B – C can have finished goods stock
• Make To Customer Forecast (MTF)
• Build to Finished Goods Supermarket
A – C Products
Products D – H sold when ??
Products D – H must have raw material stocks
• Make To Order (MTO)
• Only built when order is received
• An order for these products takes
precedence over product build to
Customer Forecast
• ALL components need to be stocked in
Raw Materials Supermarket
D – H Products
Supermarkets Shorten the Leadtime for MTO
When to Build to Customer Forecast…
9
Rev 4
Feb 5th, 04

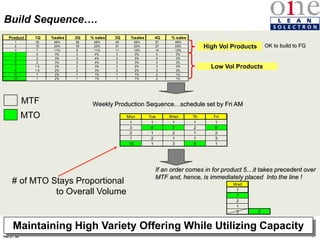

Product 1Q %sales 2Q % sales 3Q %sales 4Q % sales
1 30 48% 38 48% 45 49% 57 48%
2 15 24% 18 23% 21 23% 27 23%
3 7 11% 9 11% 11 12% 14 12%
4 2 3% 3 4% 3 3% 4 3%
5 2 3% 3 4% 3 3% 4 3%
6 2 3% 3 4% 3 3% 4 3%
7 1.5 2% 2 3% 2 2% 3 3%
8 1.5 2% 2 3% 2 2% 3 3%
9 1 2% 1 1% 1 1% 2 1%
10 1 2% 1 1% 1 1% 2 1%
Weekly Production Sequence…schedule set by Fri AM
Mon Tue Wed Th Fri
1 1 1 1 1
3 6 7 2 9
2 1 2 1 2
1 2 1 1 3
10 1 3 8 1
If an order comes in for product 5…it takes precedent over
MTF and, hence, is immediately placed Into the line !
Wed
1
7
2
1
3 5
OK to build to FG
Build Sequence….
High Vol Products
Low Vol Products
MTF
# of MTO Stays Proportional
to Overall Volume
MTO
Maintaining High Variety Offering While Utilizing Capacity
10
Rev 4
Feb 5th, 04
Guide To Level-Load
11
Rev 4
Feb 5th, 04
Guide to Level Load

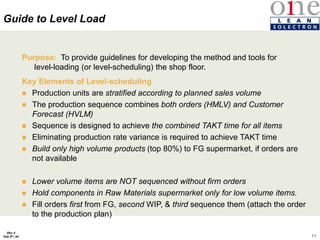

Purpose: To provide guidelines for developing the method and tools for
level-loading (or level-scheduling) the shop floor.
Key Elements of Level-scheduling
 Production units are stratified according to planned sales volume
 The production sequence combines both orders (HMLV) and Customer
Forecast (HVLM)
 Sequence is designed to achieve the combined TAKT time for all items
 Eliminating production rate variance is required to achieve TAKT time
 Build only high volume products (top 80%) to FG supermarket, if orders are
not available
 Lower volume items are NOT sequenced without firm orders
 Hold components in Raw Materials supermarket only for low volume items.
 Fill orders first from FG, second WIP, & third sequence them (attach the order
to the production plan)
12
Rev 4
Feb 5th, 04

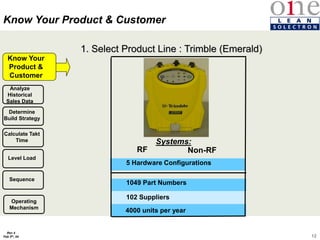

1. Select Product Line : Trimble (Emerald)
Analyze
Historical
Sales Data
Determine
Build Strategy

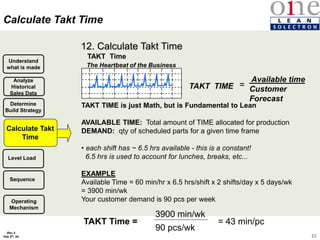

Calculate Takt
Time
Level Load
Sequence
Know Your Product & Customer
Systems:
RF Non-RF
5 Hardware Configurations
1049 Part Numbers
102 Suppliers
4000 units per year
Know Your
Product &
Customer
Operating
Mechanism
13
Rev 4
Feb 5th, 04

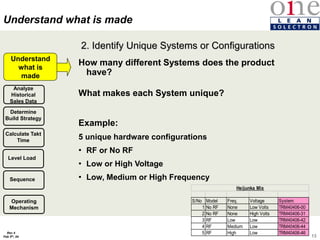

2. Identify Unique Systems or Configurations
How many different Systems does the product
have?
What makes each System unique?
Example:
5 unique hardware configurations
• RF or No RF
• Low or High Voltage
• Low, Medium or High Frequency
Analyze
Historical
Sales Data
Understand
what is
made
Determine
Build Strategy
Calculate Takt
Time
Level Load
Sequence
Understand what is made
S/No Model Freq. Voltage System
1 No RF None Low Volts TRM40406-00
2 No RF None High Volts TRM40406-31
3 RF Low Low TRM40406-42
4 RF Medium Low TRM40406-44
5 RF High Low TRM40406-46
Heijunka Mix
Operating
Mechanism
14
Rev 4
Feb 5th, 04

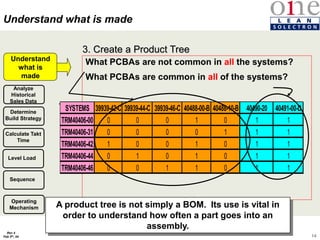

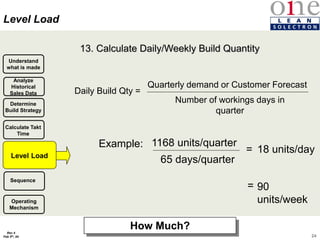

3. Create a Product Tree
Analyze
Historical
Sales Data
Determine
Build Strategy
Calculate Takt
Time
Level Load
Sequence
What PCBAs are not common in all the systems?
What PCBAs are common in all of the systems?
Understand what is made
Understand
what is
made
A product tree is not simply a BOM. Its use is vital in
order to understand how often a part goes into an
assembly.
SYSTEMS 39939-42-C 39939-44-C 39939-46-C 40488-00-B 40488-10-B 40490-20 40491-00-D
TRM40406-00 0 0 0 1 0 1 1
TRM40406-31 0 0 0 0 1 1 1
TRM40406-42 1 0 0 1 0 1 1
TRM40406-44 0 1 0 1 0 1 1
TRM40406-46 0 0 1 1 0 1 1
Operating
Mechanism
15
Rev 4
Feb 5th, 04
PCBAs
TRM 40490-20
TRM 40491-00-D
TRM 39939-42-C
TRM 39939-44-C
TRM 39939-46-C
TRM 40488-00-B
TRM 40488-10-B

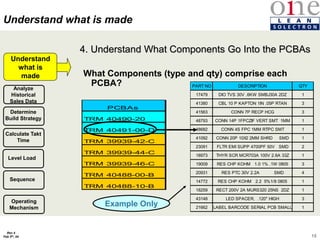

4. Understand What Components Go Into the PCBAs
What Components (type and qty) comprise each
PCBA?
Analyze
Historical
Sales Data
Determine
Build Strategy
Calculate Takt
Time
Level Load
Sequence
Understand what is made
Understand
what is
made
PART NO DESCRIPTION QTY
17479 DIO TVS 30V .6KW SMBJ30A 2DZ 1
41380 CBL 10 P KAPTON 1IN .05P RTAN 3
41563 CONN 7P RECP HCG 3
48793 CONN 14P 1FPCZIF VERT SMT 1MM 1
48682 CONN 4S FPC 1MM RTPC SMT 1
41092 CONN 20P 10X2 2MM SHRD SMD 1
23091 FLTR EMI SUPP 4700PF 50V SMD 2
18973 THYR SCR MCR703A 100V 2.6A 33Z 1
19009 RES CHP KOHM 1.0 1% .1W 0805 3
20931 RES PTC 30V 2.2A SMD 4
14772 RES CHP KOHM 2.2 5%1/8 0805 1
18259 RECT 200V 2A MURS320 25NS 2DZ 1
43148 LED SPACER, .120" HIGH 3
21662 LABEL BARCODE SERIAL PCB SMALL 1
Example Only
Operating
Mechanism
16
Rev 4
Feb 5th, 04

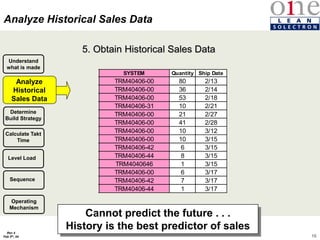

5. Obtain Historical Sales Data
Cannot predict the future . . .
History is the best predictor of sales
Understand
what is made
Analyze
Historical
Sales Data
Determine
Build Strategy
Calculate Takt
Time
Level Load
Sequence
Analyze Historical Sales Data
SYSTEM Quantity Ship Date
TRM40406-00 80 2/13
TRM40406-00 36 2/14
TRM40406-00 53 2/18
TRM40406-31 10 2/21
TRM40406-00 21 2/27
TRM40406-00 41 2/28
TRM40406-00 10 3/12
TRM40406-00 10 3/15
TRM40406-42 6 3/15
TRM40406-44 8 3/15
TRM4040646 1 3/15
TRM40406-00 6 3/17
TRM40406-42 7 3/17
TRM40406-44 1 3/17
Operating
Mechanism
17
Rev 4
Feb 5th, 04

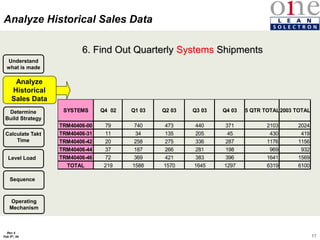

6. Find Out Quarterly Systems Shipments
Analyze
Historical
Sales Data
Determine
Build Strategy
Calculate Takt
Time
Level Load
Sequence
Understand
what is made
Analyze Historical Sales Data
SYSTEMS Q4 02 Q1 03 Q2 03 Q3 03 Q4 03 5 QTR TOTAL2003 TOTAL
TRM40406-00 79 740 473 440 371 2103 2024
TRM40406-31 11 34 135 205 45 430 419
TRM40406-42 20 258 275 336 287 1176 1156
TRM40406-44 37 187 266 281 198 969 932
TRM40406-46 72 369 421 383 396 1641 1569
TOTAL 219 1588 1570 1645 1297 6319 6100
Operating
Mechanism
18
Rev 4
Feb 5th, 04

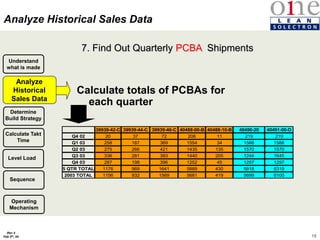

7. Find Out Quarterly PCBA Shipments
Analyze
Historical
Sales Data
Determine
Build Strategy
Calculate Takt
Time
Level Load
Sequence
Understand
what is made
Calculate totals of PCBAs for
each quarter
Analyze Historical Sales Data
39939-42-C 39939-44-C 39939-46-C 40488-00-B 40488-10-B 40490-20 40491-00-D
Q4 02 20 37 72 208 11 219 219
Q1 03 258 187 369 1554 34 1588 1588
Q2 03 275 266 421 1435 135 1570 1570
Q3 03 336 281 383 1440 205 1244 1645
Q4 03 287 198 396 1252 45 1297 1297
5 QTR TOTAL 1176 969 1641 5889 430 5918 6319
2003 TOTAL 1156 932 1569 5681 419 5699 6100
Operating
Mechanism
19
Rev 4
Feb 5th, 04

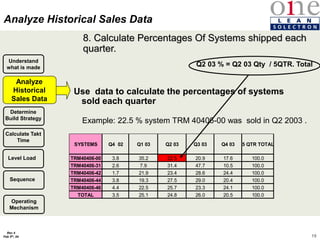

Q2 03 % = Q2 03 Qty / 5QTR. Total
8. Calculate Percentages Of Systems shipped each
quarter.
Use data to calculate the percentages of systems
sold each quarter
Analyze
Historical
Sales Data
Determine
Build Strategy
Calculate Takt
Time
Level Load
Sequence
Understand
what is made
Example: 22.5 % system TRM 40406-00 was sold in Q2 2003 .
Analyze Historical Sales Data
SYSTEMS Q4 02 Q1 03 Q2 03 Q3 03 Q4 03 5 QTR TOTAL
TRM40406-00 3.8 35.2 22.5 20.9 17.6 100.0
TRM40406-31 2.6 7.9 31.4 47.7 10.5 100.0
TRM40406-42 1.7 21.9 23.4 28.6 24.4 100.0
TRM40406-44 3.8 19.3 27.5 29.0 20.4 100.0
TRM40406-46 4.4 22.5 25.7 23.3 24.1 100.0
TOTAL 3.5 25.1 24.8 26.0 20.5 100.0
Operating
Mechanism
20
Rev 4
Feb 5th, 04

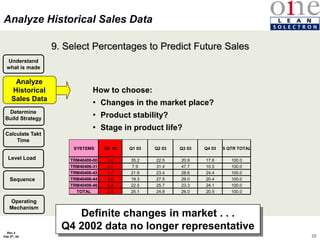

9. Select Percentages to Predict Future Sales
How to choose:
• Changes in the market place?
• Product stability?
• Stage in product life?
Analyze
Historical
Sales Data
Determine
Build Strategy
Calculate Takt
Time
Level Load
Sequence
Understand
what is made
Definite changes in market . . .
Q4 2002 data no longer representative
Analyze Historical Sales Data
SYSTEMS Q4 02 Q1 03 Q2 03 Q3 03 Q4 03 5 QTR TOTAL
TRM40406-00 3.8 35.2 22.5 20.9 17.6 100.0
TRM40406-31 2.6 7.9 31.4 47.7 10.5 100.0
TRM40406-42 1.7 21.9 23.4 28.6 24.4 100.0
TRM40406-44 3.8 19.3 27.5 29.0 20.4 100.0
TRM40406-46 4.4 22.5 25.7 23.3 24.1 100.0
TOTAL 3.5 25.1 24.8 26.0 20.5 100.0
Operating
Mechanism
21
Rev 4
Feb 5th, 04

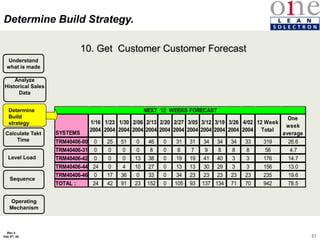

10. Get Customer Customer Forecast
Analyze
Historical Sales
Data
Determine
Build Strategy
Calculate Takt
Time
Level Load
Sequence
Understand
what is made
Determine Build Strategy.
SYSTEMS
1/16
2004
1/23
2004
1/30
2004
2/06
2004
2/13
2004
2/20
2004
2/27
2004
3/05
2004
3/12
2004
3/19
2004
3/26
2004
4/02
2004
12 Week
Total
One
week
average
TRM40406-00 0 25 51 0 46 0 31 31 34 34 34 33 319 26.6
TRM40406-31 0 0 0 0 8 0 8 7 9 8 8 8 56 4.7
TRM40406-42 0 0 0 13 38 0 19 19 41 40 3 3 176 14.7
TRM40406-44 24 0 4 10 27 0 13 13 30 29 3 3 156 13.0
TRM40406-46 0 17 36 0 33 0 34 23 23 23 23 23 235 19.6
TOTAL : 24 42 91 23 152 0 105 93 137 134 71 70 942 78.5
NEXT 12 WEEKS FORECAST
Determine
Build
strategy
Operating
Mechanism
22
Rev 4
Feb 5th, 04

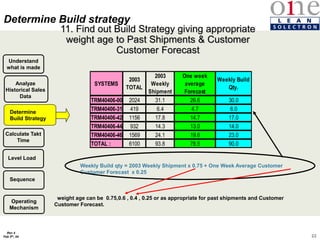

11. Find out Build Strategy giving appropriate
weight age to Past Shipments & Customer
Customer Forecast
Analyze
Historical Sales
Data
Determine
build Strategy
Calculate Takt
Time
Level Load
Sequence
Understand
what is made
Determine Build strategy
SYSTEMS
2003
TOTAL
2003
Weekly
Shipment
One week
average
Forecast
Weekly Build
Qty.
TRM40406-00 2024 31.1 26.6 30.0
TRM40406-31 419 6.4 4.7 6.0
TRM40406-42 1156 17.8 14.7 17.0
TRM40406-44 932 14.3 13.0 14.0
TRM40406-46 1569 24.1 19.6 23.0
TOTAL : 6100 93.8 78.5 90.0
Weekly Build qty = 2003 Weekly Shipment x 0.75 + One Week Average Customer
Customer Forecast x 0.25
Determine
Build Strategy
weight age can be 0.75,0.6 , 0.4 , 0.25 or as appropriate for past shipments and Customer
Customer Forecast.
Operating
Mechanism
23
Rev 4
Feb 5th, 04
12. Calculate Takt Time
Calculate Takt
Time
Determine
Build Strategy
Level Load
Sequence
Analyze
Historical
Sales Data
TAKT Time
The Heartbeat of the Business
Available time
Customer
Forecast
TAKT TIME =
TAKT TIME is just Math, but is Fundamental to Lean
AVAILABLE TIME: Total amount of TIME allocated for production
DEMAND: qty of scheduled parts for a given time frame
• each shift has ~ 6.5 hrs available - this is a constant!
6.5 hrs is used to account for lunches, breaks, etc...
EXAMPLE
Available Time = 60 min/hr x 6.5 hrs/shift x 2 shifts/day x 5 days/wk
= 3900 min/wk
Your customer demand is 90 pcs per week
3900 min/wk
90 pcs/wk
= 43 min/pc
TAKT Time =
Understand
what is made
Calculate Takt Time
Operating
Mechanism
24
Rev 4
Feb 5th, 04
13. Calculate Daily/Weekly Build Quantity
Calculate Takt
Time
Determine
Build Strategy
Level Load
Sequence
Analyze
Historical
Sales Data
Understand
what is made
Level Load
Quarterly demand or Customer Forecast
Number of workings days in
quarter
Example: 1168 units/quarter
65 days/quarter
= 18 units/day
90
units/week
How Much?
Daily Build Qty =
=
Operating
Mechanism
25
Rev 4
Feb 5th, 04
14. Calculate Daily/Weekly Mix
Calculate Takt
Time
Determine
Build Strategy
Level Load
Sequence
Analyze
Historical
Sales Data
Understand
what is made
Level Load
What Kind?
SYSTEMS DESCRIPTION
DAILY WEEKLY
TRM 40406-00 ASSY RCVR 5700 ERO 6 30
TRM 40406-46 ASSY RCVR 5700 460 5 23
TRM 40406-42 ASSY RCVR 5700 415 3 17
TRM 40406-44 ASSY RCVR 5700 440 3 14
TRM 40406-31 ASSY RCVR 5700 CORS 1 6
DAILY BUILD RATE = 18
WEEKLY BUILD RATE = 90
6 per day
33% of
daily build
Operating
Mechanism
26
Rev 4
Feb 5th, 04

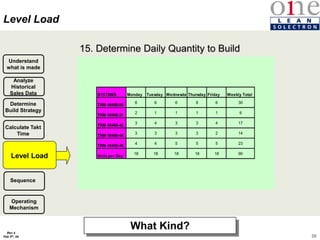

15. Determine Daily Quantity to Build
Calculate Takt
Time
Determine
Build Strategy
Level Load
Sequence
Analyze
Historical
Sales Data
Understand
what is made
Level Load
What Kind?
SYSTEMS Monday Tuesday WednesdayThursday Friday Weekly Total
TRM 40406-00
6 6 6 6 6 30
TRM 40406-31
2 1 1 1 1 6
TRM 40406-42
3 4 3 3 4 17
TRM 40406-44
3 3 3 3 2 14
TRM 40406-46
4 4 5 5 5 23
Units per Day
18 18 18 18 18 90
Operating
Mechanism
27
Rev 4
Feb 5th, 04
16. Sequence Daily Mix
Calculate Takt
Time
Determine
Build Strategy
Level Load
Sequence
Analyze
Historical
Sales Data
Understand
what is made
Sequence
High mix, low volume . . . touch
each customer everyday
Sequencing Considerations
• Optimize changeover times
• Produce to Takt Time!
SYSTEMS Monday Tuesday Wednesday Thursday Friday Weekly Total
TRM 40406-00 6 6 6 6 6 30
TRM 40406-31 2 1 1 1 1 6
TRM 40406-42 3 4 3 3 4 17
TRM 40406-44 3 3 3 3 2 14
TRM 40406-46 4 4 5 5 5 23
Units per Day 18 18 18 18 18 90
QTY. SYSTEMS QTY. SYSTEMS QTY. SYSTEMS QTY. SYSTEMS QTY. SYSTEMS
1 3 TRM 40406-00 3 TRM 40406-00 3 TRM 40406-00 3 TRM 40406-00 3 TRM 40406-00
2 1 TRM 40406-31 1 TRM 40406-31 1 TRM 40406-31 1 TRM 40406-31 1 TRM 40406-31
3 2 TRM 40406-46 2 TRM 40406-46 2 TRM 40406-46 2 TRM 40406-46 2 TRM 40406-46
4 2 TRM 40406-44 2 TRM 40406-44 2 TRM 40406-44 2 TRM 40406-44 2 TRM 40406-44
5 1 TRM 40406-42 2 TRM 40406-42 2 TRM 40406-42 2 TRM 40406-42 2 TRM 40406-42
6 3 TRM 40406-00 3 TRM 40406-00 3 TRM 40406-00 3 TRM 40406-00 3 TRM 40406-00
7 1 TRM 40406-31 2 TRM 40406-46 3 TRM 40406-46 3 TRM 40406-46 3 TRM 40406-46
8 2 TRM 40406-46 1 TRM 40406-44 1 TRM 40406-44 1 TRM 40406-44 2 TRM 40406-42
9 1 TRM 40406-44 2 TRM 40406-42 1 TRM 40406-42 1 TRM 40406-42
10 2 TRM 40406-42
Sequence
No
Friday
Monday Tuesday Wednesday Thursday
Operating
Mechanism
28
Rev 4
Feb 5th, 04
17. Create System Weekly Build Production Schedule2
Calculate Takt
Time
Determine
Build Strategy
Level Load
Sequence
Analyze
Historical
Sales Data
Understand
what is made
Sequence
MONDAY TUESDAY WEDNESDAY THURSDAY FRIDAY
6.30--7.00
7.00--7.30
7.30--8.00
8.00--8.30
8.30--9.00
9.00--9.30
9.30--10.00
10.00--10.30
10.30--11.00
11.00--11.30 Lunch
11.30--12.00
12.00--12.30
12.30--13.00
13.00--13.30
13.30--14.00
14.00-14.30
14.30--15.00
15.00--15.30
15.30--16.00
16.00--16.30
16.30--17.00
BREAK BREAK BREAK BREAK BREAK
Break Break Break Break
Break
40406-00 qty 3 40406-00 qty 3 40406-00 qty 3
40406-31 qty 1 40406-31 qty 1 40406-31 qty 1 40406-31 qty 1 40406-31 qty 1
40406-46 qty 2 40406-46 qty 2 40406-46 qty 2 40406-46 qty 2 40406-46 qty 2
40406-44 qty 2 40406-44 qty 2 40406-44 qty 2 40406-44 qty 2 40406-44 qty 2
40406-42 qty 1 40406-42 qty 2 40406-42 qty 2 40406-42 qty 2 40406-42 qty 2
Lunch Lunch Lunch Lunch
40406-00 qty 3 40406-00 qty 3 40406-00 qty 3 40406-00 qty 3
40406-00 qty 3
40406-00 qty 3 40406-00 qty 3
40406-31 qty 1
Operating
Mechanism
29
Rev 4
Feb 5th, 04
Calculate Takt
Time
Level Load
Sequence
Analyze
Historical
Sales Data
Understand
what is made
AFTER SYSTEM BUILD STRATEGY DECIDE ON PCBA BUILD AS FOLLOWS
The production plan is now your standard
SYSTEMS
One week of
Build Qty.
TRM40406-00 30
TRM40406-31 6
TRM40406-42 17
TRM40406-44 14
TRM40406-46 23
PCB A
One
Week
Build Qty.
Boards/
Panel
HEIJUNKA Kit Size
Kit Size
Normalised
Min Qty Max Qty.
Cost Per
Board $
Min Cost Max cost
39939-42-C 17 3 Once Every three weeks 51 51 10 61 $192 $1,958 $11,750
39939-44-C 14 3 Once Every three weeks 42 42 8 50 $191 $1,604 $9,626
39939-46-C 23 3 Once Every three weeks 69 69 14 83 $222 $3,064 $18,382
40488-00-B 84 2 Once Every one weeks 84 84 50 134 $317 $15,977 $42,605
40488-10-B 6 2 Once Every six weeks 36 36 4 40 $317 $1,141 $12,553
40490-20 90 4 Once Every Three weeks. 270 268 90 358 $32 $2,880 $11,456
40491-00-D 90 6 Once Every three weeks 270 270 54 324 $98 $5,292 $31,752
TOTAL 324 822 820 230 1050 $31,916 $138,124
1. Calculate weekly PCBA build qty.
2. Determine how often you will like to run a PCBA keeping Change
over time and Capacity available into consideration.
3. How often you run a PCBA also determines kit size.
4. Find out minimum qty. keeping in consideration how fast you can
build the PCBA and pull rate from system build.
5. Drop a new kit when PCBA qty. goes less than or equal to MIN Qty.
6. Keep in mind final idea is to build every PCBA every day as change
over time reduces.
Determine
Build
strategy

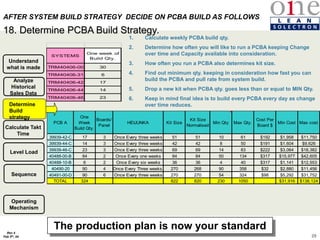

18. Determine PCBA Build Strategy.
Operating
Mechanism
30
Rev 4
Feb 5th, 04
Calculate Takt
Time
Determine
Build Strategy
Level Load
Sequence
Analyze
Historical
Sales Data
Understand
what is made
Operating Mechanisms
19. 100% Transparency Throughout Value Stream
Daily Update to Customer/Suppliers
Operating
Mechanism
SLR Customer
Supply
Chain
• Daily Pulse @ end of EACH Day1
• Total # of Units in FG
• Total # of Units in WIP (If any)
• Total # of Units in RM
• Total # of Units arriving into from Supply Chain on
Daily Basis for Rest of Week
• Total # of Units Shipped that Day
• Weekly Production Schedule2 Update (as per page 28)
1 as per
Template in page 31
31
Rev 4
Feb 5th, 04
Operating Mechanisms
20. 100% Transparency Throughout Value Stream
(Daily Pulse Template)
32
Rev 4
Feb 5th, 04

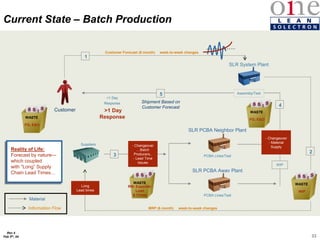

Solectron Production System :
Answer to ‘Load & Chase’
‘1month’ Inventory Cap Replenishment Upon ‘Pull’
33
Rev 4
Feb 5th, 04
WASTE
FG; E&O
SLR System Plant
Material
Information Flow
Customer
Suppliers
PCBA Lines/Test
SLR PCBA Neighbor Plant
SLR PCBA Away Plant
PCBA Lines/Test
3
Assembly/Test
4
5
WIP
<1 Day
Response Shipment Based on
Customer Forecast
2
MRP (6 month) week-to-week changes
Long
Lead times
- Changeover
…Batch
Producers..
- Lead Time
Issues
- Changeover
- Material
Supply
>1 Day
Response
1
Customer Forecast (6 month) week-to-week changes
Reality of Life:
Forecast by nature—
which coupled
with “Long” Supply
Chain Lead Times…
WASTE
FG; E&O
WASTE
WIP
WASTE
RM; Expedite;
Load
& Chase
Current State – Batch Production
34
Rev 4
Feb 5th, 04
Forecast used to “capacitize” Solectron & supply chain
Less waste and more value throughout production
Requires close participation of customers and suppliers
The future of our partnership with Customers
3
PCBA Lines/Test
PCBA Lines/Test
SLR PCBA Neighbor Plant
SLR PCBA Away Plant
WIP Supermarket
(as required)
Pull on SLR Based
on Customer Order
(not forecast)
2
4
RM Supermarket
Customer
Assembly/Test
(1 day)
SLR System Plant
On Pull
With ‘Slow’ Lead Times
Suppliers
Suppliers
Customer’s
Customer
Customer Forecast (6 months, last 2 months=weekly/last 2 weeks=daily)
1
MRP (6 month)
Vision 2004 : From Batch to Pull
35
Rev 4
Feb 5th, 04
Vision 2004 : From Batch to Pull
Guiding Principles :
a) Solectron will communicate to Customers that we will hold maximum of ‘1 month’ of Inventory (of
last quarter’s actual shipments)….in Finished Goods/WIP/Raw Material.
b) Additional Material and Production will be directly tied to Customer PULL.
c) The cap will be ‘1 month’ of last quarter’s actual shipments.
d) VERY Important :
1. Raw Material (RM) : should be measured in # of Units (not in $$ alone) & a measure ‘% of
Balanced Inventory’ ie. Run your BOM through RM Inventory to see how many units can
you ‘physically’ make….that converted into a $ amount of inventory divided by total $ in RM
is the % of Balanced Inventory.
2. Keep a constant tab on ‘incoming’ inventory in # of units
3. Do a cycle count ‘daily’ till you get 100% accuracy discipline
Daily Discipline of 5S & Supermarket
are ‘fundamental’ for success
36
Rev 4
Feb 5th, 04
Takt Time Production
Work Balancing Next Kaizen Focus
37
Rev 4
Feb 5th, 04
Stop @
Abnormality
Takt Time
Production
Single
Piece Flow
Pull
Production
Autonomation
Sequencing
Level
Loading
JIT Jidoka
Heijunka
SPS
The House of Solectron
VSM, 5S, Supermarkets
Adding Value and Eliminating Waste
38
Rev 4
Feb 5th, 04
Takt Time…The Heartbeat of the Business
Available time
Customer Forecast
TAKT TIME =
TAKT TIME is just Math, but is Fundamental to Lean
AVAILABLE TIME: Total amount of TIME allocated for production
DEMAND: qty of scheduled parts for a given time frame
• each shift has ~ 6.5 hrs available - this is a constant!
6.5 hrs is used to account for lunches, breaks, etc...
EXAMPLE
Available Time = 60 min/hr x 6.5 hrs/shift x 2 shifts/day x 5 days/wk
= 3900 min/wk
Your customer demand is 90 pcs per week
3900 min/wk
90 pcs/wk
= 43 min/pc
TAKT Time =
39
Rev 4
Feb 5th, 04
Manpower Calculation
Product Hourly
Requirement
Work Content
Time
TAKT Time
System 1 4 units 25 min 5 min
System 2 2 units 44 min 10 min
System 3 2 units 30 min 10 min
Total 8 units Weighted
WCTime =
31min
7.5 min
Line Staffing =
Weighted Average
Work Content Time
Takt Time
[ (4/8) *25] + [(2/8)*44] + [(2/8)*30]
7.5 min /pcs
= = 4.13
Kaizen
Example:
4
40
Rev 4
Feb 5th, 04
Work Balance
Time
Person
A B D
C
Time
Person
Takt/Time
A B D
64”
C
Bottleneck
Wasted Time / Waiting
41
Rev 4
Feb 5th, 04
What We’re Striving For …
Time
Person
A B D
C
Time
Person
Takt/Time
A B D
64”
C
Bottleneck
Reduce
Wasted Time / Waiting
Balanced Operations…
Station by Station…Line by Line
42
Rev 4
Feb 5th, 04
Guide To Sequencing
43
Rev 4
Feb 5th, 04
Need to Determine . . .
How Much 20 systems per day
What Kind 15 of System G
5 of System R
When 5 of G, 2 of R, 5 of G,
2 of R, 5 of G, 1 of R
TAKT
Level Load Mix
Level Load
Sequence
If we were making Systems. . .
Quarterly
Weekly
Weekly
Frequency
Takt Time =
Available Time
Demand/Customer Forecast
Assumptions:
1) Machine Breakdown = 0 hour
2) Setup Change = 0 hour
3) Defect Rate = 0%

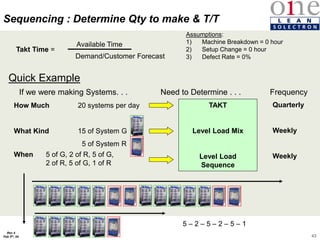

Sequencing : Determine Qty to make & T/T
Quick Example
5 – 2 – 5 – 2 – 5 – 1
44
Rev 4
Feb 5th, 04
Setting the production sequence of multiple Types
Product Monthly
Requirement
Daily
Requirement
TAKT Time
System 1 720 units 24 units 5 min
System 2 360 units 12 units 10 min
System 3 360 units 12 units 10 min
Total 1440 units 48 units 7.5 min
This is data for 3 products, System 1, System 2, and System 3.
The chart displays the monthly production level, the daily production level (monthly divided by 30),
and the Takt time for each product type.
THEY ARE ALL PRODUCED ON THE SAME LINE.
How can these units be built in a level production mode using this example?
System
1
System
2
System
3
Sequencing : Determine Qty to make & to T/T
45
Rev 4
Feb 5th, 04

Since these three products are on the same line, you will need to follow the sequence
pattern of 1-2-1-3 in your production mix. By doing it this way you are able to level-
load your production both in terms of quantity and types.
System 1 System 3
System 2 System 1
REPEAT
Mixed
Assembly
Line
Production Sequence by Type
0
2.5
5
7.5
10
12.5
15
Model 1 Model 2 Model 3
Takt
Time
0
2.5
5
7.5
10
12.5
15
Model 1, 2 Model 1, 3
Takt
Time
Model 3
Model 2
Model 1
If produced in batches, only the System 1’s
will be built within 7.5 minute Takt times
If produced to a sequence, 2 units will be
produced in 2 Takt times, or 15 minutes
Let’s show how we validate this…
1-2-1-3
46
Rev 4
Feb 5th, 04
Syste
m
Line
Takt
Takt/Cycle
Graph
Part - Quantity
Part Router
1
3
2 7.5
7.5
7.5
See Std Work
Combo Sheet for
example. One sheet
is created for each
operator
Sort By Volume
0
2000
4000
6000
8000
10000
1
2
3
3
1
2
3
4
1
3
5
7
1
9
4
6
2
3
4
5
2
4
6
8
2
8
3
3
2
8
9
4
3
4
5
6
3
5
7
9
3
8
5
5
4
5
6
7
5
6
7
8
6
7
8
9
8
2
4
8
9
9
9
1
Part Number
Quantity
0
0.2
0.4
0.6
0.8
1
Percentage
SCT=25
7
6
6 6
7
6
13
8
12
7.5
9
7.5
Step
No.
OperationName
Time
Manual Auto Travel
ProductionReq'd Takt/Rate Time Manual
Auto
Travel
Wait
~~~~~~~~
Organization Area Supervisor
New / Rev Page of Date
ProductionLine
Part Number
Part Name
Operator
Standard Work
Combination Sheet
Totals OperationTime
Sec ( ) Min( ) Hr ( )
1 1 2/6/02 AMX
Shannon
X-Ray Station 1 & 2 J. David
1
2
3
4
5
6
7
Check Motor
Issue DHR
Install Gen. Housing
Install Clips
Install Term. Strip
Install/Wire Latch
Jumper Wire to Filter
10 20 30 40 50 60 70 80 90
74
T/T
3
2
10
5
6
4
10
3
2
5
4
6
4
6
30
40
X
Step
No.
OperationName
Time
Manual Auto Travel
ProductionReq'd Takt/Rate Time Manual
Auto
Travel
Wait
~~~~~~~~
Organization Area Supervisor
New / Rev Page of Date
ProductionLine
Part Number
Part Name
Operator
Standard Work
Combination Sheet
Totals OperationTime
Sec ( ) Min( ) Hr ( )
1 1 2/6/02 AMX
Shannon
X-Ray Station 1 & 2 J. David
1
2
3
4
5
6
7
Check Motor
Issue DHR
Install Gen. Housing
Install Clips
Install Term. Strip
Install/Wire Latch
Jumper Wire to Filter
10 20 30 40 50 60 70 80 90
74
T/T
3
2
10
5
6
4
10
3
2
5
4
6
4
6
30
40
X
Step
No.
OperationName
Time
Manual Auto Travel
ProductionReq'd Takt/Rate Time Manual
Auto
Travel
Wait
~~~~~~~~
Organization Area Supervisor
New / Rev Page of Date
ProductionLine
Part Number
Part Name
Operator
Standard Work
Combination Sheet
Totals OperationTime
Sec ( ) Min( ) Hr ( )
1 1 2/6/02 AMX
Shannon
X-Ray Station 1 & 2 J. David
1
2
3
4
5
6
7
Check Motor
Issue DHR
Install Gen. Housing
Install Clips
Install Term. Strip
Install/Wire Latch
Jumper Wire to Filter
10 20 30 40 50 60 70 80 90
74
T/T
3
2
10
5
6
4
10
3
2
5
4
6
4
6
30
40
X
SCT=40
SCT=30
S
t
e
p
1
S
t
e
p
2
S
t
e
p
3
S
t
e
p
4
S
t
e
p
5
Model 1 X X X X
Model 2 X X X
Model 3 X X X
47
Rev 4
Feb 5th, 04
Takt Build Time= # of Operations * Takt
Actual Build Time =SCT
1 30
2 30
3 30
1 25
2 40
3 30
System TBT
System ABT

1 -5
2 +10
3 0
System
Objectives: Produce to Takt Time (understanding no 2 products will have the exact same ABT)
• The sum of the DTot is zero
• Every product is produced at least once
• No product is produced twice in a row
Create a product sequence where:
Dtot = S(# of Units in sequence* D)
Dtot = -5(# of 1’s)+10(# of 2’s)+0(# of 3’s)
0 = -5(2)+10(1)+0(1)
According to the rules the sequence
must run:
System 1 – System 2 – System 1 –
System 3
48
Rev 4
Feb 5th, 04
Takt Time Production
Work Balancing Next Kaizen Focus
49
Rev 4
Feb 5th, 04
Stop @
Abnormality
Takt Time
Production
Single
Piece Flow
Pull
Production
Autonomation
Sequencing
Level
Loading
JIT Jidoka
Heijunka
SPS
The House of Solectron
VSM, 5S, Supermarkets
Adding Value and Eliminating Waste
50
Rev 4
Feb 5th, 04
Takt Time…The Heartbeat of the Business
Available time
Customer Forecast
TAKT TIME =
TAKT TIME is just Math, but is Fundamental to Lean
AVAILABLE TIME: Total amount of TIME allocated for production
DEMAND: qty of scheduled parts for a given time frame
• each shift has ~ 6.5 hrs available - this is a constant!
6.5 hrs is used to account for lunches, breaks, etc...
EXAMPLE
Available Time = 60 min/hr x 6.5 hrs/shift x 2 shifts/day x 5 days/wk
= 3900 min/wk
Your customer demand is 90 pcs per week
3900 min/wk
90 pcs/wk
= 43 min/pc
TAKT Time =
51
Rev 4
Feb 5th, 04
Manpower Calculation
Product Hourly
Requirement
Work Content
Time
TAKT Time
System 1 4 units 25 min 5 min
System 2 2 units 44 min 10 min
System 3 2 units 30 min 10 min
Total 8 units Weighted
WCTime =
31min
7.5 min
Line Staffing =
Weighted Average
Work Content Time
Takt Time
[ (4/8) *25] + [(2/8)*44] + [(2/8)*30]
7.5 min /pcs
= = 4.13
Kaizen
Example:
4
52
Rev 4
Feb 5th, 04
Work Balance
Time
Person
A B D
C
Time
Person
Takt/Time
A B D
64”
C
Bottleneck
Wasted Time / Waiting
53
Rev 4
Feb 5th, 04
What We’re Striving For …
Time
Person
A B D
C
Time
Person
Takt/Time
A B D
64”
C
Bottleneck
Reduce
Wasted Time / Waiting
Balanced Operations…
Station by Station…Line by Line
54
Rev 4
Feb 5th, 04
Single Piece Flow
Std Work 3P (Production Prep Process)
55
Rev 4
Feb 5th, 04
Stop @
Abnormality
Takt Time
Production
Single
Piece Flow
Pull
Production
Autonomation
Sequencing
Level Loading
JIT Jidoka
Heijunka
SPS
The House of Solectron
VSM, 5S, Supermarkets
Adding Value and Eliminating Waste
56
Rev 4
Feb 5th, 04
JIT Jidoka
Heijunka
SPS
Stop @
Abnormality
Takt Time
Production
Single
Piece Flow
Pull
Production
Autonomation
Sequencing
Level
Loading
The House of Solectron
VSM, 5S, Supermarkets
Adding Value and Eliminating Waste
57
Rev 4
Feb 5th, 04

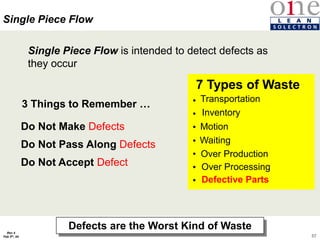

Do Not Make Defects
Do Not Pass Along Defects
Do Not Accept Defect
Defects are the Worst Kind of Waste
Single Piece Flow is intended to detect defects as
they occur
3 Things to Remember …
Single Piece Flow
7 Types of Waste
•
Defective Parts
•
Over Production
•
Inventory
•
Motion
•
Transportation
•
Waiting
•
Over Processing
58
Rev 4
Feb 5th, 04
Building Quality into the Process
The Next Process is the Customer … Never Send Defects !
Catches Defects too Late
• How many more do you have?
• Where are they in the process?
• What is the root cause?
Catches Defects Immediately
• You only have one
• You know where it occurred
• Resolve the root cause immediately
Batch Single Piece Flow
From: The Solectron Production System
59
Rev 4
Feb 5th, 04
Single Piece Flow
Guidelines for Cell Layout
Good Cell Layout Makes Work Redistribution Easy
 Place Workstations Close Together to Minimize
Walking Distance
 Keep Inside Width of a Cell at 5 feet to Allow Flexibility in
Work Redistribution
 Locate the Leadoff and Final Processes Near one Another
 Eliminate Spaces and Surface where WIP can Accumulate
 Use Dedicated Hand Tools and Gravity to Assist Operators
 Absolutely ensure Safety and Good Ergonomics
 5S
Materials
Machines
Cell Layout
60
Rev 4
Feb 5th, 04
Materials
Machines
Cell Layout
Single Piece Flow
Guidelines for Machine
Good Machine Design Enables Operator Focus
on Manual Content
 Use small equipment dedicated to a single task
 Introduce Auto-Eject When Operators Must Use Both Hands
 Install One-Touch Automation Where Possible
 Incorporate Sensors to Signal Abnormal Conditions, so
Operators Do not Need to Watch Machines During Cycle
 Avoid Batching
 At Pacemaker, Strive to Devise Machine Changeover
Between Different Assemblies Take Less than 1 TAKT Cycle
61
Rev 4
Feb 5th, 04
Single Piece Flow
Guidelines for Materials
Good Material Flow Improves Productivity
 Present Parts as Close as Possible to the Point of Use
 Present Parts so Operators can use Both Hand Simultaneously
 Do not Have Operators Get or Restock Their Own Parts
 Keep No More than 2 Hours of Material at the Point of Use
 Do not Put Additional Parts Storage in or Near the Process
 Utilize Kanban to Regulate Parts Replenishment
 Size Part Bin for the Convenience of the Operator, Not for
the Convenience of the Material Handler or Supplying Process
Materials
Machines
Cell Layout
62
Rev 4
Feb 5th, 04

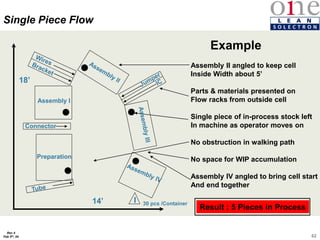

Single Piece Flow
18’
14’
Assembly I
Connector
Preparation
Assembly II angled to keep cell
Inside Width about 5’
Parts & materials presented on
Flow racks from outside cell
Single piece of in-process stock left
In machine as operator moves on
No obstruction in walking path
No space for WIP accumulation
Assembly IV angled to bring cell start
And end together
I 30 pcs /Container
Example
Result : 5 Pieces in Process
63
Rev 4
Feb 5th, 04
Standard Work
64
Rev 4
Feb 5th, 04
JIT Jidoka
Heijunka
SPS
Stop @
Abnormality
Takt Time
Production
Single
Piece Flow
Pull
Production
Autonomation
Sequencing
Level
Loading
The House of Solectron
VSM, 5S, Supermarkets
Adding Value and Eliminating Waste
65
Rev 4
Feb 5th, 04
What is Standard Work?
Standard Work is a combination of actions performed
by humans and machines carrying out value-added
work in an efficient way in the right sequence & right
time, enabled by material & information flow, using
the right tools as required. It is the foundation for a
lean enterprise.
(1) TAKT Time
(2) Work sequence (order of operations)
(3) Standard work-in-process
Standard Work Definition
Three Elements of Standard Work
66
Rev 4
Feb 5th, 04
Why Have Standard Work?
(1) To make manufacturing rules explicit
Establish the methods for manual tasks with respect to
safety, quality, quantity and cost.
(2) A tool for KAIZEN
Establish baseline for future improvement
Standard Work - Objective
There Is No Improvement In The Absence Of Standards
67
Rev 4
Feb 5th, 04
(1) Human motions must be central to the operation
(2) The Operation must be repetitive
(3) “Blue print” for how the shop should run
Variation = Risk Of Poor Quality
Elements of Standard Work
68
Rev 4
Feb 5th, 04
TAKT Time
The Heartbeat of the Business
1st Element of Standard Work
Standard
WIP
Work
Sequence
TAKT Time
4
1
Available time
Customer Forecast
TAKT TIME =
TAKT TIME is just Math, but is Fundamental to Lean
AVAILABLE TIME: Total amount of TIME allocated for production
DEMAND: qty of scheduled parts for a given time frame
• each shift has ~ 6.5 hrs available - this is a constant!
6.5 hrs is used to account for lunches, breaks, etc...
EXAMPLE
Available Time = 60 min/hr x 6.5 hrs/shift x 2 shifts/day x 5 days/wk
= 3900 min/wk
Your customer demand is 90 pcs per week
3900 min/wk
90 pcs/wk
= 43 min/pc
TAKT Time =
69
Rev 4
Feb 5th, 04
Work Sequence
The order of operations in which a worker
places parts on a machine or in an assembly.
The Same Thing, The Same Way, Every Time
4
2
Standard
WIP
Work
Sequence
TAKT Time
machine processing
     
2nd Element of Standard Work
70
Rev 4
Feb 5th, 04

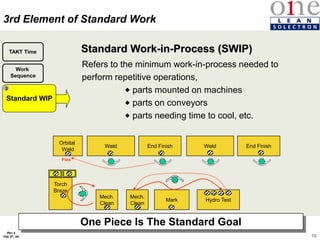

Standard Work-in-Process (SWIP)
Refers to the minimum work-in-process needed to
perform repetitive operations,
 parts mounted on machines
 parts on conveyors
 parts needing time to cool, etc.
One Piece Is The Standard Goal
TAKT Time
Standard WIP
Work
Sequence
4
3
End Finish
Weld
End Finish
Weld
Orbital
Weld
Hydro Test
Mark
Mech.
Clean
Torch
Braze
Mech.
Clean
Flex
3rd Element of Standard Work
71
Rev 4
Feb 5th, 04

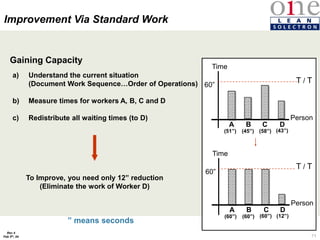

Gaining Capacity
a) Understand the current situation
(Document Work Sequence…Order of Operations)
b) Measure times for workers A, B, C and D
c) Redistribute all waiting times (to D)
Time
Person
T / T
A B C D
60”
(51”) (45”) (58”) (43”)
Time
Person
T / T
A B D
60”
(60”) (60”) (60”) (12”)
C
To Improve, you need only 12” reduction
(Eliminate the work of Worker D)
Improvement Via Standard Work
” means seconds
72
Rev 4
Feb 5th, 04
Carry out individual Kaizen and balance out the tasks on the basis of standard
operations for workers A, B, C, and D.
Any waste in walking from one work station to
another?
look at how parts are placed and the positions
of operation tables
Operational variability…
look for any unreasonable postures and movements
Hand movements …
look at how parts are placed and the location of
start buttons
Improvements …
determine whether the net time can be shortened;
resolve the imbalances
Kaizen
T / T
A B C D
60”
(60”) (60”) (60”) (12”)
By eliminating MUDA
Improvement Via Standard Work
Eliminating Waste
73
Rev 4
Feb 5th, 04
Enhancing Production Capacity
How to increase production capacity
machine processing
MANUAL AUTOMATED
2 min for completion
     
1 minute 1 minute
Improvement Via Standard Work
74
Rev 4
Feb 5th, 04
     

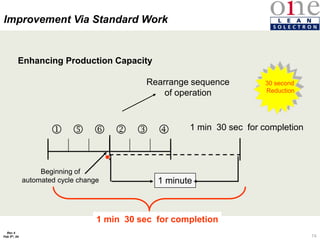

1 minute
1 min 30 sec for completion

Beginning of
automated cycle change
1 min 30 sec for completion
30 second
Reduction
Rearrange sequence
of operation
Enhancing Production Capacity
Improvement Via Standard Work
75
Rev 4
Feb 5th, 04

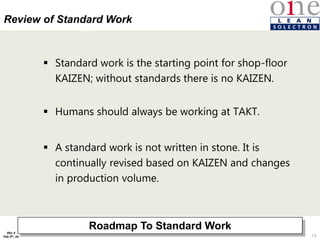

 Standard work is the starting point for shop-floor
KAIZEN; without standards there is no KAIZEN.
 Humans should always be working at TAKT.
 A standard work is not written in stone. It is
continually revised based on KAIZEN and changes
in production volume.
Roadmap To Standard Work
Review of Standard Work
76
Rev 4
Feb 5th, 04
Tools for Standard Work
Time Measurement Sheet Capacity Sheet
Combination Table Standard Work Chart Work Instruction
77
Rev 4
Feb 5th, 04
Time Measurement Sheet
78
Rev 4
Feb 5th, 04
Capacity Sheet
79
Rev 4
Feb 5th, 04
Step
No.
Operation Name
Time
Manual Auto Travel
Production Req'd Takt/Rate Time Manual
Auto
Travel
Wait
~~~~~~~~
Organization Area Supervisor
New / Rev Page of Date
Production Line
Part Number
Part Name
Operator
Standard Work
Combination Sheet
Totals Operation Time
Sec ( ) Min ( ) Hr ( )
Enter the travel time
Enter the unit of measured time
Enter Any machine Automatic Run
Time. This operation!
Enter the Any Manual Time
(Hands On)
Enter the operation Name
Screen Print
One sheet per
Operator!!!
x
5 35 5
T/T
5 10 15 20 25 30 35
1
3.9 min
1
2 SMT 10 0 2
3 Reflow 10 8
4 wait 0 0 0
Op/Step numbers
4
25 73 10
Process Capacity Sheet Data
1/09/03 Sun
RU18P03
PCBA Board
A 1 1
1000
Standard Work Combination Table
Harjinder Bajwa
80
Rev 4
Feb 5th, 04
Organization Area Supervisor
New / Rev Page of Date
Production Line
Part Number
Part Name
Operator
Standard Work Sheet
To:
Turns DPU's
Scope of Operations
From:
Quality
Check
Safety
Precaution
Standard
Work-in-Process
# Lots of
Standard
Work-in-Process
Takt/Rate
Time
Total Manual & Travel Time
Man/Travel Time
Operator
Inspection
Wave
Hand Load
Connector
Stage
Test
Mark
Stage
Touch Up
PCBA Bldg 3 Harjinder Bajwa
1
All Parts
Sun PCBA
1 1
Clean
Raw material
Configure
100/Day
ICT
5DX
Funt Test
2nd Qtr. ‘04
Pack
Outside Cell
27 - avg lot = 6
Flex
Finished Goods

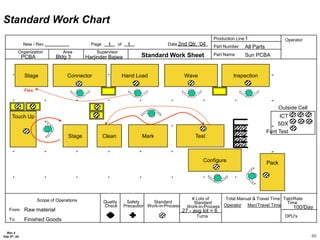

Standard Work Chart
81
Rev 4
Feb 5th, 04
Work Instruction
82
Rev 4
Feb 5th, 04
Work forms should be located in each work area
1
2
3
6
5
4
• Work
Capacity
• Combination
Table
• Work
instructions
• Standard
Work Charts
World-class work typically have a binder at each workstation with work forms and process instructions (e.g.,
part drawings, engineering instructions, descriptions of final use). Work capacity and combination table are
visually posted because they are real problem-solving forms used on a continuous basis
Work Instruction
83
Rev 4
Feb 5th, 04
3P (Production Preparation Process)
Managed Creativity
84
Rev 4
Feb 5th, 04
Tools for 3P
7 Designs 7 Ways

Pugh Matrix Golf Score Sheet
&
The
7
Designs
Each
member
of
the
team
should
work
independently
and
using
/
combining
the
ideas
from
nature,
develop
7
designs
for
the
desired
function.
Don’t
fear
to
document
any
design
that
you
wish…after
all
you
should
be
thinking
with
a
twelve
year
old
mind
.
Please
use
pictures
and
enough
detail
to
be
able
to
explain
your
ideas
to
other
team
members.
1
7
1 2 3 4 5 6 7
Process
Method
Jig
/
Fixture
Hand
Tool
No-Go
Gage
Poke
-
Yoke
Machine
7 ways
For Each Process
Part
Process Sketch Quality Requirements
7 Ways
Operation 10 20 30 40 50 60 70 80 90 100 110 120 130 140 150 160 Sum
1 Meet Takt Time
2 One Piece Flow
3 Min. Oper. Involement ( Load / Start )
4 Hanedashi
5 Chaku - Chaku
6 Poke Yoke
7 Min. Capitol Required
8 100% Gaging
9 Value Adding Operation
10 Smed
11 No Tool Room Maintenance
12 Tooling Cost + 30%
13 3D ( Dangerous, Dirty, Difficult )
14 As Simple As Possible
15 Readily Available Equipment
16 6 Sigma Process Capaility
17 Known Process To GE
18 Future Challenge
19 Maintenance Free Machines
20 Technology Familiar To GE
21 Jidoka
22 Min. Time To Develop
OVERALL PROCESS RATING
Rating: 5 - Excellant
4 - Above Average
3 - Average
2 - Below Average
1 - Poor
0 - N/A
Process Evaluation
Pugh Matrix
88
Rev 4
Feb 5th, 04
SCORE DESCRIPTION
OPERATION
COUNTER
HAND-AS-
FIXTURE ADDER
(+10)
AWKWARD
HEIGHT ADDER
(+10)
1 Operation done in a
downward motion.
3 Operation done in a
sideways motion.
10 Operation done in a
upward motion.
100 Operation done in
non-visible location
Place a 1 in the "Operation Counter" each time an operation is completed as described. The count of all 1's should equal the total number of
operations. Also place 1's in the "Adder" columns as appropriate for a specific operation. These will adjust the total score. Example: if an
operation is done in a sideways motion, put a 1 in the Operation Counter section for a 3 point score. If an operation is done in a sideways motion
at an awkward height, put a 1 in the Operation Counter for a 3 point score, and a 1 in the Awkward Height Adder column. The total points for that
1 operation then is 13.
Assembly Golf Score
Golf Score Tool
89
Rev 4
Feb 5th, 04
Pull Production
90
Rev 4
Feb 5th, 04
JIT Jidoka
Heijunka
SPS
Stop @
Abnormality
Takt Time
Production
Single
Piece Flow
Pull
Production
Autonomation
Sequencing
Level
Loading
The House of Solectron
VSM, 5S, Supermarkets
Adding Value and Eliminating Waste
91
Rev 4
Feb 5th, 04

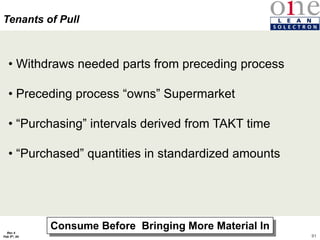

• Withdraws needed parts from preceding process
• Preceding process “owns” Supermarket
• “Purchasing” intervals derived from TAKT time
• “Purchased” quantities in standardized amounts
Tenants of Pull
Consume Before Bringing More Material In
92
Rev 4
Feb 5th, 04

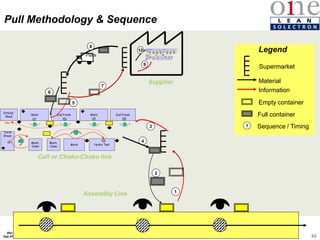

1
2
End Finish
Weld
End Finish
Weld
Orbital
Weld
Hydro Test
Mark
Mech.
Clean
Torch
Braze
Mech.
Clean
Flex
End Finish
Weld
End Finish
Weld
Orbital
Weld
Hydro Test
Mark
Mech.
Clean
Torch
Braze
Mech.
Clean
Flex
3
4
Cell or Chaku-Chaku line
Parts
7
8
9
10 End Finish
Weld
End Finish
Weld
Orbital
Weld
Hydro Test
Mark
Mech.
Clean
Torch
Braze
Mech.
Clean
Flex
End Finish
Weld
End Finish
Weld
Orbital
Weld
Hydro Test
Mark
Mech.
Clean
Torch
Braze
Mech.
Clean
Flex
Supplier Material
Information
Supermarket
Empty container
Full container
Legend
1 Sequence / Timing
Pull Methodology & Sequence
Assembly Line
5
6
93
Rev 4
Feb 5th, 04
JIT Jidoka
Heijunka
SPS
Stop @
Abnormality
Takt Time
Production
Single
Piece Flow
Pull
Production
Autonomation
Sequencing
Level
Loading
The House of Solectron
VSM, 5S, Supermarkets
Adding Value and Eliminating Waste
94
Rev 4
Feb 5th, 04
Kanban System
95
Rev 4
Feb 5th, 04

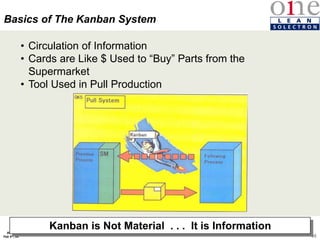

• Circulation of Information
• Cards are Like $ Used to “Buy” Parts from the
Supermarket
• Tool Used in Pull Production
Basics of The Kanban System
Kanban is Not Material . . . It is Information
96
Rev 4
Feb 5th, 04

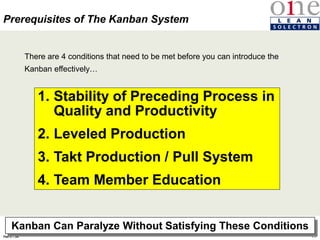

There are 4 conditions that need to be met before you can introduce the
Kanban effectively…
1. Stability of Preceding Process in
Quality and Productivity
2. Leveled Production
3. Takt Production / Pull System
4. Team Member Education
Prerequisites of The Kanban System
Kanban Can Paralyze Without Satisfying These Conditions
97
Rev 4
Feb 5th, 04
• Physical Goods Control: Movement of Kanban corresponds to physical goods
• Instruction of Operation: What do you produce and how many?
• Tool for Kaizen: Easier to see material deficiencies
Roles of Kanban
The Chain of Kanbans Spans From Customers to Suppliers
98
Rev 4
Feb 5th, 04
Types of Kanban
6 Types of Kanban can be classified as follows:
1. Production Kanban
Specifies the type and quantity in which the previous process has to
produce the product.
2. Withdraw Kanban
Specifies the address where the parts need to go.
Each Type for Specific Points in the Process
Kanban
Production
Kanban
In-Process Kanban
Signal Kanban
Inter-Process Kanban
Supplier Kanban
Withdraw
Kanban
99
Rev 4
Feb 5th, 04
Example of In-Process Kanban
Kanban Gives Instruction for the Process to Produce
In-Process Kanban
The card is pulled from the containers to start the reorder “only” when
The first part in the container is used
100
Rev 4
Feb 5th, 04
Example of Signal Kanban
Overproduction is the Mother of all Waste
Qty/
Pallet
54
Pallet
Reorder
QTY
6
Part Number
87EFGT3457AH
Component Name
Front Bracket L/H
Line Number
L16
Lot Size
540
Reorder
QTY
270
The card is placed when parts are withdrawn at the re-order point
Signal Kanban
101
Rev 4
Feb 5th, 04
Example of Kanban
Signal Kanban is Used when Changeover Time is Long
In-Process
Kanban
Signal
Kanban
Reorder
Point
Stocking Height should not exceed the visual line for safety reason
102
Rev 4
Feb 5th, 04
Rules of Kanban System
Kanban is a Forcing Function to Reduce Overproduction
 Defective Parts Must not be Passed on
 The Consuming Process Comes to Withdraw Parts
 Produce to Replenish Only What is Withdrawn
 Parts Must not be Produced or Conveyed Without
Kanban
 Kanban Must be Attached to the Parts or Container
 The Quantity of Parts in the Container Must Match
Exactly the Number on the Kanban
Withdrawal
Kanban
Production
Kanban
Kanban System
103
Rev 4
Feb 5th, 04
Rules of Production Kanban
Kanban is not Effective if the Rules are not Followed
 Quantity of Parts Produced Must Equal the Quantity
of Parts Withdrawn
 Quantity Listed on Kanban Must Equal the Quantity
Per Container
 Kanban Must be Attached and Visible on the Part
Container
 Parts Must Remain in Stores at the Production Process
Until Withdrawn by the Following Process
Withdrawal
Kanban
Production
Kanban
Kanban System
104
Rev 4
Feb 5th, 04
Rules of Withdrawal Kanban
Discipline Required to Implement Kanban Systems
 Parts Must be Picked up from the Preceding Process
 Parts are not to be Withdrawn Without a Kanban
 Quantity of Parts Withdrawn Must Equal the Number
of Parts Ordered by the Kanban
 The Withdrawal Kanban Must be Attached to the
Parts Withdrawn so That it is Visible
 The Parts Withdrawn Must be Put in the Designated
Area at the Following Process
Withdrawal
Kanban
Production
Kanban
Kanban System
105
Rev 4
Feb 5th, 04

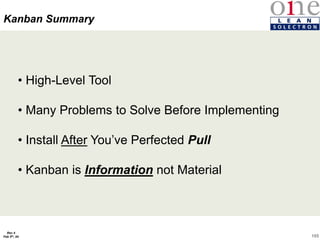

Kanban Summary
• High-Level Tool
• Many Problems to Solve Before Implementing
• Install After You’ve Perfected Pull
• Kanban is Information not Material
106
Rev 4
Feb 5th, 04
Dec.12.2003(PART-2)
IBARAKI
KANBAN System
(Pull Production System)
Rev.2 Dec.12.2003
107
Rev 4
Feb 5th, 04
1. Outline of KANBAN System
2. High Mix Low Volume Production
3. Layout Image of Server Biz
4. KANBAN Stream
5. KANBAN Types
6. KANBAN Samples
7. Role of WATER SPIDER
8. Activities of WATER SPIDER
--Please go and watch “Our (Ibaraki) Lean Lines”--
Contents
108
Rev 4
Feb 5th, 04
(Supply Chain)
Minimum Parts stock

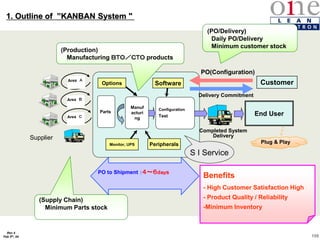

1. Outline of ”KANBAN System "
Benefits
- High Customer Satisfaction High
- Product Quality / Reliability
-Minimum Inventory
(PO/Delivery)
Daily PO/Delivery
Minimum customer stock
Configuration
Test
Software
Delivery Commitment
End User
PO(Configuration)
S I Service
Customer
Monitor, UPS Peripherals
PO to Shipment :4~6days
Parts
(Production)
Manufacturing BTO/CTO products
Plug & Play
Supplier
Options
Manuf
acturi
ng
Completed System
Delivery
109
Rev 4
Feb 5th, 04
Logistic Network
Small volume & Frequent Parts and Products Delivery
Possibility to direct Delivery for End User
Kanazawa Niigata
Sapporo
Kagoshima
Yamaguchi
Sendai
Yamagata
Koriyama
Osaka
Takamats
u
Nagano
Nagoy
a
Shizuok
a
Kofu
Akita
Morioka
Tokyo
SLR-Ibaraki
Daily network figure in
Japan
Fukuoka
Kumamoto Hiroshima
110
Rev 4
Feb 5th, 04
2. High Mix Low Volume Production
SMT
(2 line) Box Build
POST
SMT
Supplier
1time/day
Frequency
24hrs 20mins 20mins 20mins 20mins 2hrs
Board Assembly
4times/day
Box
W/H
Board
W/H
FGS
PO(Configuration)
Customer
Lot size less than 20pcs
80% 1Pc 1Unit
Kind/day 60 130 200(Box)
1,000(Option)
Q’ty/Mth 14,000 14,000 4,300(Box)
20,000(Option)
111

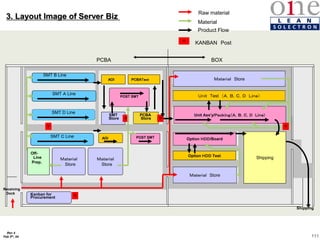

Rev 4
Feb 5th, 04
Option HDD Test
Option HDD/Board
Unit Ass'y/Packing(A,B,C,D Line)
Unit Test (A,B,C,D Line)
Material Store
Raw material
Material
Product Flow
Shipping
Shipping
Material Store
SMT B Line
Material
Store
Material
Store
POST SMT
PCBA
Store
Kanban for
Procurement
SMT
Store
Off-
Line
Prep.
Receiving
Dock
BOX
PCBA
SMT C Line
SMT D Line
SMT A Line
〒
〒
〒
〒
〒
3. Layout Image of Server Biz
PCBATest
〒
KANBAN Post
POST SMT
AOI
AOI
112
Rev 4
Feb 5th, 04
Option HDD Test
Option HDD/Board
Unit Ass'y/Packing(A,B,C,D Line)
Unit Test (A,B,C,D Line)
Material Store
Shipping
Shipping
Material Store
SMT B Line
Material
Store
Material
Store
PCBA
Store
Kanban for
Procurement
SMT
Store
Off-
Line
Prep.
Receiving
Dock
BOX
PCBA
SMT C Line
SMT D Line
SMT A Line
〒
〒
〒
〒
〒
PartsPrep.
PartsPrep.

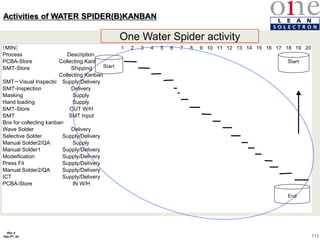

4. KANBAN Stream
(A)KANBAN
(D)KANBAN
(B)KANBAN
(C)KANBAN
Raw material
KANBAN+Material
Only KANBAN
〒
KANBAN Post
PCBATest
AOI
POST SMT
AOI POST SMT
113
Rev 4
Feb 5th, 04
(MIN) 1 2 3 4 5 6 7 8 9 10 11 12 13 14 15 16 17 18 19 20
Process Description
PCBA-Store Collecting Kanban
SMT-Store Shipping
Collecting Kanban
SMT-Visual Inspection Supply/Delivery
SMT-Inspection Delivery
Masking Supply
Hand loading Supply
SMT-Store OUT W/H
SMT SMT Input
Box for collecting kanban
Wave Solder Delivery
Selective Solder Supply/Delivery
Manual Solder2/QA Supply
Manual Solder1 Supply/Delivery
Modeification Supply/Delivery
Press Fit Supply/Delivery
Manual Solder2/QA Supply/Delivery
ICT Supply/Delivery
PCBA-Store IN W/H
Start
End
Start
One Water Spider activity
Activities of WATER SPIDER(B)KANBAN
114
Rev 4
Feb 5th, 04
Pull KANBAN Pull KANBAN for Inter-process
Delivery KANBAN
(Supplier KANBAN)
Definition :
Instruction KANBAN – Instruct the production
Pull KANBAN – Instruct to pull from pre-process
only the post-process used quantities.
Instruction KANBAN Intra-process KANBAN
5. KANBAN Types
Example
(Ibaraki)
A,B,C
A,B
D
115
Rev 4
Feb 5th, 04
6. KANBAN Samples
(A) --Instruction/Pull KANBAN(Box Build)--
116
Rev 4
Feb 5th, 04
6. KANBAN Samples
(B)-- Instruction/Pull KANBAN(Post SMT) --
117
Rev 4
Feb 5th, 04
6. KANBAN Samples
(C)-- Instruction KANBAN(SMT) --
118
Rev 4
Feb 5th, 04
6. KANBAN Samples
(D)-- Delivery KANBAN (Supplier) --
119
Rev 4
Feb 5th, 04
1) Production Instruction
-Instruct production to each process.
2) Delivery
-Supply parts to each process
-Supply WIP to next process
7. Role of WATER SPIDER
120
Rev 4
Feb 5th, 04
8. Activities of WATER SPIDER
-- Please go and watch
“Our (Ibaraki) Lean Lines” --

Lean_Basics_Part_II_Rev4.ppt

  • 1.
    Solectron Production System SixSigma Lean Lean Basics Part II Functional Excellence Rev 4, February 5th 04
  • 2.
    2 Rev 4 Feb 5th,04 Stop @ Abnormality Takt Time Production Single Piece Flow Pull Production Autonomation Sequencing Level Loading JIT Jidoka Heijunka SPS The House of Solectron VSM, 5S, Supermarkets Adding Value and Eliminating Waste
  • 3.
    3 Rev 4 Feb 5th,04 5. Prod Prep Process 4. JIT Pull Production Takt Time Single Piece Flow • Takt Time • Standard WIP • Op Sequence Standard work 8. Kan Ban 6. Flow 7. JIDOKA Stop at Abnormalities Human Intellegence into machines 1.5S Seiri Seiton Seiso Seiketsu Shitsuke 2. Material Presentation Supermarket Kitting 3. HEIJUNKA Level Loading Sequencing Time Sequential Application of Tools Degree of Change + Impact Value Stream is the Foundation
  • 4.
    4 Rev 4 Feb 5th,04 Heijunka Level Loading Sequencing
  • 5.
    5 Rev 4 Feb 5th,04 Stop @ Abnormality Takt Time Production Single Piece Flow Pull Production Autonomation Sequencing Level Loading JIT Jidoka Heijunka SPS The House of Solectron VSM, 5S, Supermarkets Adding Value and Eliminating Waste Leveling = Process of smoothing the overall schedule by more frequent mixing of High & Low volume Sequencing = The order in which the parts on a multi-product line or cell are processed.
  • 6.
    6 Rev 4 Feb 5th,04 Customer Demand Leveled production • How Can a Shop Resource This ? • How Can the Supply Chain Cope ? • What if the Supply Chain is Global ? Heijunka is a Forcing Function Heijunka Heijunka
  • 7.
    7 Rev 4 Feb 5th,04 Customer Demand More leveled production Heijunka PaceMaker Finish Goods Supermarket Day-to-Day Volume Fluctuation • Single Scheduling Point • Down Stream Processes Occur as a Flow Pacemaker Sets the Pace for Upstream Processes
  • 8.
    8 Rev 4 Feb 5th,04 A B C D E F G H 2002 2003 ~ 80 % of Sales Products A – B – C will be sold frequently Products A – B – C can have finished goods stock • Make To Customer Forecast (MTF) • Build to Finished Goods Supermarket A – C Products Products D – H sold when ?? Products D – H must have raw material stocks • Make To Order (MTO) • Only built when order is received • An order for these products takes precedence over product build to Customer Forecast • ALL components need to be stocked in Raw Materials Supermarket D – H Products Supermarkets Shorten the Leadtime for MTO When to Build to Customer Forecast…
  • 9.
    9 Rev 4 Feb 5th,04 Product 1Q %sales 2Q % sales 3Q %sales 4Q % sales 1 30 48% 38 48% 45 49% 57 48% 2 15 24% 18 23% 21 23% 27 23% 3 7 11% 9 11% 11 12% 14 12% 4 2 3% 3 4% 3 3% 4 3% 5 2 3% 3 4% 3 3% 4 3% 6 2 3% 3 4% 3 3% 4 3% 7 1.5 2% 2 3% 2 2% 3 3% 8 1.5 2% 2 3% 2 2% 3 3% 9 1 2% 1 1% 1 1% 2 1% 10 1 2% 1 1% 1 1% 2 1% Weekly Production Sequence…schedule set by Fri AM Mon Tue Wed Th Fri 1 1 1 1 1 3 6 7 2 9 2 1 2 1 2 1 2 1 1 3 10 1 3 8 1 If an order comes in for product 5…it takes precedent over MTF and, hence, is immediately placed Into the line ! Wed 1 7 2 1 3 5 OK to build to FG Build Sequence…. High Vol Products Low Vol Products MTF # of MTO Stays Proportional to Overall Volume MTO Maintaining High Variety Offering While Utilizing Capacity
  • 10.
    10 Rev 4 Feb 5th,04 Guide To Level-Load
  • 11.
    11 Rev 4 Feb 5th,04 Guide to Level Load Purpose: To provide guidelines for developing the method and tools for level-loading (or level-scheduling) the shop floor. Key Elements of Level-scheduling  Production units are stratified according to planned sales volume  The production sequence combines both orders (HMLV) and Customer Forecast (HVLM)  Sequence is designed to achieve the combined TAKT time for all items  Eliminating production rate variance is required to achieve TAKT time  Build only high volume products (top 80%) to FG supermarket, if orders are not available  Lower volume items are NOT sequenced without firm orders  Hold components in Raw Materials supermarket only for low volume items.  Fill orders first from FG, second WIP, & third sequence them (attach the order to the production plan)
  • 12.
    12 Rev 4 Feb 5th,04 1. Select Product Line : Trimble (Emerald) Analyze Historical Sales Data Determine Build Strategy Calculate Takt Time Level Load Sequence Know Your Product & Customer Systems: RF Non-RF 5 Hardware Configurations 1049 Part Numbers 102 Suppliers 4000 units per year Know Your Product & Customer Operating Mechanism
  • 13.
    13 Rev 4 Feb 5th,04 2. Identify Unique Systems or Configurations How many different Systems does the product have? What makes each System unique? Example: 5 unique hardware configurations • RF or No RF • Low or High Voltage • Low, Medium or High Frequency Analyze Historical Sales Data Understand what is made Determine Build Strategy Calculate Takt Time Level Load Sequence Understand what is made S/No Model Freq. Voltage System 1 No RF None Low Volts TRM40406-00 2 No RF None High Volts TRM40406-31 3 RF Low Low TRM40406-42 4 RF Medium Low TRM40406-44 5 RF High Low TRM40406-46 Heijunka Mix Operating Mechanism
  • 14.
    14 Rev 4 Feb 5th,04 3. Create a Product Tree Analyze Historical Sales Data Determine Build Strategy Calculate Takt Time Level Load Sequence What PCBAs are not common in all the systems? What PCBAs are common in all of the systems? Understand what is made Understand what is made A product tree is not simply a BOM. Its use is vital in order to understand how often a part goes into an assembly. SYSTEMS 39939-42-C 39939-44-C 39939-46-C 40488-00-B 40488-10-B 40490-20 40491-00-D TRM40406-00 0 0 0 1 0 1 1 TRM40406-31 0 0 0 0 1 1 1 TRM40406-42 1 0 0 1 0 1 1 TRM40406-44 0 1 0 1 0 1 1 TRM40406-46 0 0 1 1 0 1 1 Operating Mechanism
  • 15.
    15 Rev 4 Feb 5th,04 PCBAs TRM 40490-20 TRM 40491-00-D TRM 39939-42-C TRM 39939-44-C TRM 39939-46-C TRM 40488-00-B TRM 40488-10-B 4. Understand What Components Go Into the PCBAs What Components (type and qty) comprise each PCBA? Analyze Historical Sales Data Determine Build Strategy Calculate Takt Time Level Load Sequence Understand what is made Understand what is made PART NO DESCRIPTION QTY 17479 DIO TVS 30V .6KW SMBJ30A 2DZ 1 41380 CBL 10 P KAPTON 1IN .05P RTAN 3 41563 CONN 7P RECP HCG 3 48793 CONN 14P 1FPCZIF VERT SMT 1MM 1 48682 CONN 4S FPC 1MM RTPC SMT 1 41092 CONN 20P 10X2 2MM SHRD SMD 1 23091 FLTR EMI SUPP 4700PF 50V SMD 2 18973 THYR SCR MCR703A 100V 2.6A 33Z 1 19009 RES CHP KOHM 1.0 1% .1W 0805 3 20931 RES PTC 30V 2.2A SMD 4 14772 RES CHP KOHM 2.2 5%1/8 0805 1 18259 RECT 200V 2A MURS320 25NS 2DZ 1 43148 LED SPACER, .120" HIGH 3 21662 LABEL BARCODE SERIAL PCB SMALL 1 Example Only Operating Mechanism
  • 16.
    16 Rev 4 Feb 5th,04 5. Obtain Historical Sales Data Cannot predict the future . . . History is the best predictor of sales Understand what is made Analyze Historical Sales Data Determine Build Strategy Calculate Takt Time Level Load Sequence Analyze Historical Sales Data SYSTEM Quantity Ship Date TRM40406-00 80 2/13 TRM40406-00 36 2/14 TRM40406-00 53 2/18 TRM40406-31 10 2/21 TRM40406-00 21 2/27 TRM40406-00 41 2/28 TRM40406-00 10 3/12 TRM40406-00 10 3/15 TRM40406-42 6 3/15 TRM40406-44 8 3/15 TRM4040646 1 3/15 TRM40406-00 6 3/17 TRM40406-42 7 3/17 TRM40406-44 1 3/17 Operating Mechanism
  • 17.
    17 Rev 4 Feb 5th,04 6. Find Out Quarterly Systems Shipments Analyze Historical Sales Data Determine Build Strategy Calculate Takt Time Level Load Sequence Understand what is made Analyze Historical Sales Data SYSTEMS Q4 02 Q1 03 Q2 03 Q3 03 Q4 03 5 QTR TOTAL2003 TOTAL TRM40406-00 79 740 473 440 371 2103 2024 TRM40406-31 11 34 135 205 45 430 419 TRM40406-42 20 258 275 336 287 1176 1156 TRM40406-44 37 187 266 281 198 969 932 TRM40406-46 72 369 421 383 396 1641 1569 TOTAL 219 1588 1570 1645 1297 6319 6100 Operating Mechanism
  • 18.
    18 Rev 4 Feb 5th,04 7. Find Out Quarterly PCBA Shipments Analyze Historical Sales Data Determine Build Strategy Calculate Takt Time Level Load Sequence Understand what is made Calculate totals of PCBAs for each quarter Analyze Historical Sales Data 39939-42-C 39939-44-C 39939-46-C 40488-00-B 40488-10-B 40490-20 40491-00-D Q4 02 20 37 72 208 11 219 219 Q1 03 258 187 369 1554 34 1588 1588 Q2 03 275 266 421 1435 135 1570 1570 Q3 03 336 281 383 1440 205 1244 1645 Q4 03 287 198 396 1252 45 1297 1297 5 QTR TOTAL 1176 969 1641 5889 430 5918 6319 2003 TOTAL 1156 932 1569 5681 419 5699 6100 Operating Mechanism
  • 19.
    19 Rev 4 Feb 5th,04 Q2 03 % = Q2 03 Qty / 5QTR. Total 8. Calculate Percentages Of Systems shipped each quarter. Use data to calculate the percentages of systems sold each quarter Analyze Historical Sales Data Determine Build Strategy Calculate Takt Time Level Load Sequence Understand what is made Example: 22.5 % system TRM 40406-00 was sold in Q2 2003 . Analyze Historical Sales Data SYSTEMS Q4 02 Q1 03 Q2 03 Q3 03 Q4 03 5 QTR TOTAL TRM40406-00 3.8 35.2 22.5 20.9 17.6 100.0 TRM40406-31 2.6 7.9 31.4 47.7 10.5 100.0 TRM40406-42 1.7 21.9 23.4 28.6 24.4 100.0 TRM40406-44 3.8 19.3 27.5 29.0 20.4 100.0 TRM40406-46 4.4 22.5 25.7 23.3 24.1 100.0 TOTAL 3.5 25.1 24.8 26.0 20.5 100.0 Operating Mechanism
  • 20.
    20 Rev 4 Feb 5th,04 9. Select Percentages to Predict Future Sales How to choose: • Changes in the market place? • Product stability? • Stage in product life? Analyze Historical Sales Data Determine Build Strategy Calculate Takt Time Level Load Sequence Understand what is made Definite changes in market . . . Q4 2002 data no longer representative Analyze Historical Sales Data SYSTEMS Q4 02 Q1 03 Q2 03 Q3 03 Q4 03 5 QTR TOTAL TRM40406-00 3.8 35.2 22.5 20.9 17.6 100.0 TRM40406-31 2.6 7.9 31.4 47.7 10.5 100.0 TRM40406-42 1.7 21.9 23.4 28.6 24.4 100.0 TRM40406-44 3.8 19.3 27.5 29.0 20.4 100.0 TRM40406-46 4.4 22.5 25.7 23.3 24.1 100.0 TOTAL 3.5 25.1 24.8 26.0 20.5 100.0 Operating Mechanism
  • 21.
    21 Rev 4 Feb 5th,04 10. Get Customer Customer Forecast Analyze Historical Sales Data Determine Build Strategy Calculate Takt Time Level Load Sequence Understand what is made Determine Build Strategy. SYSTEMS 1/16 2004 1/23 2004 1/30 2004 2/06 2004 2/13 2004 2/20 2004 2/27 2004 3/05 2004 3/12 2004 3/19 2004 3/26 2004 4/02 2004 12 Week Total One week average TRM40406-00 0 25 51 0 46 0 31 31 34 34 34 33 319 26.6 TRM40406-31 0 0 0 0 8 0 8 7 9 8 8 8 56 4.7 TRM40406-42 0 0 0 13 38 0 19 19 41 40 3 3 176 14.7 TRM40406-44 24 0 4 10 27 0 13 13 30 29 3 3 156 13.0 TRM40406-46 0 17 36 0 33 0 34 23 23 23 23 23 235 19.6 TOTAL : 24 42 91 23 152 0 105 93 137 134 71 70 942 78.5 NEXT 12 WEEKS FORECAST Determine Build strategy Operating Mechanism
  • 22.
    22 Rev 4 Feb 5th,04 11. Find out Build Strategy giving appropriate weight age to Past Shipments & Customer Customer Forecast Analyze Historical Sales Data Determine build Strategy Calculate Takt Time Level Load Sequence Understand what is made Determine Build strategy SYSTEMS 2003 TOTAL 2003 Weekly Shipment One week average Forecast Weekly Build Qty. TRM40406-00 2024 31.1 26.6 30.0 TRM40406-31 419 6.4 4.7 6.0 TRM40406-42 1156 17.8 14.7 17.0 TRM40406-44 932 14.3 13.0 14.0 TRM40406-46 1569 24.1 19.6 23.0 TOTAL : 6100 93.8 78.5 90.0 Weekly Build qty = 2003 Weekly Shipment x 0.75 + One Week Average Customer Customer Forecast x 0.25 Determine Build Strategy weight age can be 0.75,0.6 , 0.4 , 0.25 or as appropriate for past shipments and Customer Customer Forecast. Operating Mechanism
  • 23.
    23 Rev 4 Feb 5th,04 12. Calculate Takt Time Calculate Takt Time Determine Build Strategy Level Load Sequence Analyze Historical Sales Data TAKT Time The Heartbeat of the Business Available time Customer Forecast TAKT TIME = TAKT TIME is just Math, but is Fundamental to Lean AVAILABLE TIME: Total amount of TIME allocated for production DEMAND: qty of scheduled parts for a given time frame • each shift has ~ 6.5 hrs available - this is a constant! 6.5 hrs is used to account for lunches, breaks, etc... EXAMPLE Available Time = 60 min/hr x 6.5 hrs/shift x 2 shifts/day x 5 days/wk = 3900 min/wk Your customer demand is 90 pcs per week 3900 min/wk 90 pcs/wk = 43 min/pc TAKT Time = Understand what is made Calculate Takt Time Operating Mechanism
  • 24.
    24 Rev 4 Feb 5th,04 13. Calculate Daily/Weekly Build Quantity Calculate Takt Time Determine Build Strategy Level Load Sequence Analyze Historical Sales Data Understand what is made Level Load Quarterly demand or Customer Forecast Number of workings days in quarter Example: 1168 units/quarter 65 days/quarter = 18 units/day 90 units/week How Much? Daily Build Qty = = Operating Mechanism
  • 25.
    25 Rev 4 Feb 5th,04 14. Calculate Daily/Weekly Mix Calculate Takt Time Determine Build Strategy Level Load Sequence Analyze Historical Sales Data Understand what is made Level Load What Kind? SYSTEMS DESCRIPTION DAILY WEEKLY TRM 40406-00 ASSY RCVR 5700 ERO 6 30 TRM 40406-46 ASSY RCVR 5700 460 5 23 TRM 40406-42 ASSY RCVR 5700 415 3 17 TRM 40406-44 ASSY RCVR 5700 440 3 14 TRM 40406-31 ASSY RCVR 5700 CORS 1 6 DAILY BUILD RATE = 18 WEEKLY BUILD RATE = 90 6 per day 33% of daily build Operating Mechanism
  • 26.
    26 Rev 4 Feb 5th,04 15. Determine Daily Quantity to Build Calculate Takt Time Determine Build Strategy Level Load Sequence Analyze Historical Sales Data Understand what is made Level Load What Kind? SYSTEMS Monday Tuesday WednesdayThursday Friday Weekly Total TRM 40406-00 6 6 6 6 6 30 TRM 40406-31 2 1 1 1 1 6 TRM 40406-42 3 4 3 3 4 17 TRM 40406-44 3 3 3 3 2 14 TRM 40406-46 4 4 5 5 5 23 Units per Day 18 18 18 18 18 90 Operating Mechanism
  • 27.
    27 Rev 4 Feb 5th,04 16. Sequence Daily Mix Calculate Takt Time Determine Build Strategy Level Load Sequence Analyze Historical Sales Data Understand what is made Sequence High mix, low volume . . . touch each customer everyday Sequencing Considerations • Optimize changeover times • Produce to Takt Time! SYSTEMS Monday Tuesday Wednesday Thursday Friday Weekly Total TRM 40406-00 6 6 6 6 6 30 TRM 40406-31 2 1 1 1 1 6 TRM 40406-42 3 4 3 3 4 17 TRM 40406-44 3 3 3 3 2 14 TRM 40406-46 4 4 5 5 5 23 Units per Day 18 18 18 18 18 90 QTY. SYSTEMS QTY. SYSTEMS QTY. SYSTEMS QTY. SYSTEMS QTY. SYSTEMS 1 3 TRM 40406-00 3 TRM 40406-00 3 TRM 40406-00 3 TRM 40406-00 3 TRM 40406-00 2 1 TRM 40406-31 1 TRM 40406-31 1 TRM 40406-31 1 TRM 40406-31 1 TRM 40406-31 3 2 TRM 40406-46 2 TRM 40406-46 2 TRM 40406-46 2 TRM 40406-46 2 TRM 40406-46 4 2 TRM 40406-44 2 TRM 40406-44 2 TRM 40406-44 2 TRM 40406-44 2 TRM 40406-44 5 1 TRM 40406-42 2 TRM 40406-42 2 TRM 40406-42 2 TRM 40406-42 2 TRM 40406-42 6 3 TRM 40406-00 3 TRM 40406-00 3 TRM 40406-00 3 TRM 40406-00 3 TRM 40406-00 7 1 TRM 40406-31 2 TRM 40406-46 3 TRM 40406-46 3 TRM 40406-46 3 TRM 40406-46 8 2 TRM 40406-46 1 TRM 40406-44 1 TRM 40406-44 1 TRM 40406-44 2 TRM 40406-42 9 1 TRM 40406-44 2 TRM 40406-42 1 TRM 40406-42 1 TRM 40406-42 10 2 TRM 40406-42 Sequence No Friday Monday Tuesday Wednesday Thursday Operating Mechanism
  • 28.
    28 Rev 4 Feb 5th,04 17. Create System Weekly Build Production Schedule2 Calculate Takt Time Determine Build Strategy Level Load Sequence Analyze Historical Sales Data Understand what is made Sequence MONDAY TUESDAY WEDNESDAY THURSDAY FRIDAY 6.30--7.00 7.00--7.30 7.30--8.00 8.00--8.30 8.30--9.00 9.00--9.30 9.30--10.00 10.00--10.30 10.30--11.00 11.00--11.30 Lunch 11.30--12.00 12.00--12.30 12.30--13.00 13.00--13.30 13.30--14.00 14.00-14.30 14.30--15.00 15.00--15.30 15.30--16.00 16.00--16.30 16.30--17.00 BREAK BREAK BREAK BREAK BREAK Break Break Break Break Break 40406-00 qty 3 40406-00 qty 3 40406-00 qty 3 40406-31 qty 1 40406-31 qty 1 40406-31 qty 1 40406-31 qty 1 40406-31 qty 1 40406-46 qty 2 40406-46 qty 2 40406-46 qty 2 40406-46 qty 2 40406-46 qty 2 40406-44 qty 2 40406-44 qty 2 40406-44 qty 2 40406-44 qty 2 40406-44 qty 2 40406-42 qty 1 40406-42 qty 2 40406-42 qty 2 40406-42 qty 2 40406-42 qty 2 Lunch Lunch Lunch Lunch 40406-00 qty 3 40406-00 qty 3 40406-00 qty 3 40406-00 qty 3 40406-00 qty 3 40406-00 qty 3 40406-00 qty 3 40406-31 qty 1 Operating Mechanism
  • 29.
    29 Rev 4 Feb 5th,04 Calculate Takt Time Level Load Sequence Analyze Historical Sales Data Understand what is made AFTER SYSTEM BUILD STRATEGY DECIDE ON PCBA BUILD AS FOLLOWS The production plan is now your standard SYSTEMS One week of Build Qty. TRM40406-00 30 TRM40406-31 6 TRM40406-42 17 TRM40406-44 14 TRM40406-46 23 PCB A One Week Build Qty. Boards/ Panel HEIJUNKA Kit Size Kit Size Normalised Min Qty Max Qty. Cost Per Board $ Min Cost Max cost 39939-42-C 17 3 Once Every three weeks 51 51 10 61 $192 $1,958 $11,750 39939-44-C 14 3 Once Every three weeks 42 42 8 50 $191 $1,604 $9,626 39939-46-C 23 3 Once Every three weeks 69 69 14 83 $222 $3,064 $18,382 40488-00-B 84 2 Once Every one weeks 84 84 50 134 $317 $15,977 $42,605 40488-10-B 6 2 Once Every six weeks 36 36 4 40 $317 $1,141 $12,553 40490-20 90 4 Once Every Three weeks. 270 268 90 358 $32 $2,880 $11,456 40491-00-D 90 6 Once Every three weeks 270 270 54 324 $98 $5,292 $31,752 TOTAL 324 822 820 230 1050 $31,916 $138,124 1. Calculate weekly PCBA build qty. 2. Determine how often you will like to run a PCBA keeping Change over time and Capacity available into consideration. 3. How often you run a PCBA also determines kit size. 4. Find out minimum qty. keeping in consideration how fast you can build the PCBA and pull rate from system build. 5. Drop a new kit when PCBA qty. goes less than or equal to MIN Qty. 6. Keep in mind final idea is to build every PCBA every day as change over time reduces. Determine Build strategy 18. Determine PCBA Build Strategy. Operating Mechanism
  • 30.
    30 Rev 4 Feb 5th,04 Calculate Takt Time Determine Build Strategy Level Load Sequence Analyze Historical Sales Data Understand what is made Operating Mechanisms 19. 100% Transparency Throughout Value Stream Daily Update to Customer/Suppliers Operating Mechanism SLR Customer Supply Chain • Daily Pulse @ end of EACH Day1 • Total # of Units in FG • Total # of Units in WIP (If any) • Total # of Units in RM • Total # of Units arriving into from Supply Chain on Daily Basis for Rest of Week • Total # of Units Shipped that Day • Weekly Production Schedule2 Update (as per page 28) 1 as per Template in page 31
  • 31.
    31 Rev 4 Feb 5th,04 Operating Mechanisms 20. 100% Transparency Throughout Value Stream (Daily Pulse Template)
  • 32.
    32 Rev 4 Feb 5th,04 Solectron Production System : Answer to ‘Load & Chase’ ‘1month’ Inventory Cap Replenishment Upon ‘Pull’
  • 33.
    33 Rev 4 Feb 5th,04 WASTE FG; E&O SLR System Plant Material Information Flow Customer Suppliers PCBA Lines/Test SLR PCBA Neighbor Plant SLR PCBA Away Plant PCBA Lines/Test 3 Assembly/Test 4 5 WIP <1 Day Response Shipment Based on Customer Forecast 2 MRP (6 month) week-to-week changes Long Lead times - Changeover …Batch Producers.. - Lead Time Issues - Changeover - Material Supply >1 Day Response 1 Customer Forecast (6 month) week-to-week changes Reality of Life: Forecast by nature— which coupled with “Long” Supply Chain Lead Times… WASTE FG; E&O WASTE WIP WASTE RM; Expedite; Load & Chase Current State – Batch Production
  • 34.
    34 Rev 4 Feb 5th,04 Forecast used to “capacitize” Solectron & supply chain Less waste and more value throughout production Requires close participation of customers and suppliers The future of our partnership with Customers 3 PCBA Lines/Test PCBA Lines/Test SLR PCBA Neighbor Plant SLR PCBA Away Plant WIP Supermarket (as required) Pull on SLR Based on Customer Order (not forecast) 2 4 RM Supermarket Customer Assembly/Test (1 day) SLR System Plant On Pull With ‘Slow’ Lead Times Suppliers Suppliers Customer’s Customer Customer Forecast (6 months, last 2 months=weekly/last 2 weeks=daily) 1 MRP (6 month) Vision 2004 : From Batch to Pull
  • 35.
    35 Rev 4 Feb 5th,04 Vision 2004 : From Batch to Pull Guiding Principles : a) Solectron will communicate to Customers that we will hold maximum of ‘1 month’ of Inventory (of last quarter’s actual shipments)….in Finished Goods/WIP/Raw Material. b) Additional Material and Production will be directly tied to Customer PULL. c) The cap will be ‘1 month’ of last quarter’s actual shipments. d) VERY Important : 1. Raw Material (RM) : should be measured in # of Units (not in $$ alone) & a measure ‘% of Balanced Inventory’ ie. Run your BOM through RM Inventory to see how many units can you ‘physically’ make….that converted into a $ amount of inventory divided by total $ in RM is the % of Balanced Inventory. 2. Keep a constant tab on ‘incoming’ inventory in # of units 3. Do a cycle count ‘daily’ till you get 100% accuracy discipline Daily Discipline of 5S & Supermarket are ‘fundamental’ for success
  • 36.
    36 Rev 4 Feb 5th,04 Takt Time Production Work Balancing Next Kaizen Focus
  • 37.
    37 Rev 4 Feb 5th,04 Stop @ Abnormality Takt Time Production Single Piece Flow Pull Production Autonomation Sequencing Level Loading JIT Jidoka Heijunka SPS The House of Solectron VSM, 5S, Supermarkets Adding Value and Eliminating Waste
  • 38.
    38 Rev 4 Feb 5th,04 Takt Time…The Heartbeat of the Business Available time Customer Forecast TAKT TIME = TAKT TIME is just Math, but is Fundamental to Lean AVAILABLE TIME: Total amount of TIME allocated for production DEMAND: qty of scheduled parts for a given time frame • each shift has ~ 6.5 hrs available - this is a constant! 6.5 hrs is used to account for lunches, breaks, etc... EXAMPLE Available Time = 60 min/hr x 6.5 hrs/shift x 2 shifts/day x 5 days/wk = 3900 min/wk Your customer demand is 90 pcs per week 3900 min/wk 90 pcs/wk = 43 min/pc TAKT Time =
  • 39.
    39 Rev 4 Feb 5th,04 Manpower Calculation Product Hourly Requirement Work Content Time TAKT Time System 1 4 units 25 min 5 min System 2 2 units 44 min 10 min System 3 2 units 30 min 10 min Total 8 units Weighted WCTime = 31min 7.5 min Line Staffing = Weighted Average Work Content Time Takt Time [ (4/8) *25] + [(2/8)*44] + [(2/8)*30] 7.5 min /pcs = = 4.13 Kaizen Example: 4
  • 40.
    40 Rev 4 Feb 5th,04 Work Balance Time Person A B D C Time Person Takt/Time A B D 64” C Bottleneck Wasted Time / Waiting
  • 41.
    41 Rev 4 Feb 5th,04 What We’re Striving For … Time Person A B D C Time Person Takt/Time A B D 64” C Bottleneck Reduce Wasted Time / Waiting Balanced Operations… Station by Station…Line by Line
  • 42.
    42 Rev 4 Feb 5th,04 Guide To Sequencing
  • 43.
    43 Rev 4 Feb 5th,04 Need to Determine . . . How Much 20 systems per day What Kind 15 of System G 5 of System R When 5 of G, 2 of R, 5 of G, 2 of R, 5 of G, 1 of R TAKT Level Load Mix Level Load Sequence If we were making Systems. . . Quarterly Weekly Weekly Frequency Takt Time = Available Time Demand/Customer Forecast Assumptions: 1) Machine Breakdown = 0 hour 2) Setup Change = 0 hour 3) Defect Rate = 0% Sequencing : Determine Qty to make & T/T Quick Example 5 – 2 – 5 – 2 – 5 – 1
  • 44.
    44 Rev 4 Feb 5th,04 Setting the production sequence of multiple Types Product Monthly Requirement Daily Requirement TAKT Time System 1 720 units 24 units 5 min System 2 360 units 12 units 10 min System 3 360 units 12 units 10 min Total 1440 units 48 units 7.5 min This is data for 3 products, System 1, System 2, and System 3. The chart displays the monthly production level, the daily production level (monthly divided by 30), and the Takt time for each product type. THEY ARE ALL PRODUCED ON THE SAME LINE. How can these units be built in a level production mode using this example? System 1 System 2 System 3 Sequencing : Determine Qty to make & to T/T
  • 45.
    45 Rev 4 Feb 5th,04 Since these three products are on the same line, you will need to follow the sequence pattern of 1-2-1-3 in your production mix. By doing it this way you are able to level- load your production both in terms of quantity and types. System 1 System 3 System 2 System 1 REPEAT Mixed Assembly Line Production Sequence by Type 0 2.5 5 7.5 10 12.5 15 Model 1 Model 2 Model 3 Takt Time 0 2.5 5 7.5 10 12.5 15 Model 1, 2 Model 1, 3 Takt Time Model 3 Model 2 Model 1 If produced in batches, only the System 1’s will be built within 7.5 minute Takt times If produced to a sequence, 2 units will be produced in 2 Takt times, or 15 minutes Let’s show how we validate this… 1-2-1-3
  • 46.
    46 Rev 4 Feb 5th,04 Syste m Line Takt Takt/Cycle Graph Part - Quantity Part Router 1 3 2 7.5 7.5 7.5 See Std Work Combo Sheet for example. One sheet is created for each operator Sort By Volume 0 2000 4000 6000 8000 10000 1 2 3 3 1 2 3 4 1 3 5 7 1 9 4 6 2 3 4 5 2 4 6 8 2 8 3 3 2 8 9 4 3 4 5 6 3 5 7 9 3 8 5 5 4 5 6 7 5 6 7 8 6 7 8 9 8 2 4 8 9 9 9 1 Part Number Quantity 0 0.2 0.4 0.6 0.8 1 Percentage SCT=25 7 6 6 6 7 6 13 8 12 7.5 9 7.5 Step No. OperationName Time Manual Auto Travel ProductionReq'd Takt/Rate Time Manual Auto Travel Wait ~~~~~~~~ Organization Area Supervisor New / Rev Page of Date ProductionLine Part Number Part Name Operator Standard Work Combination Sheet Totals OperationTime Sec ( ) Min( ) Hr ( ) 1 1 2/6/02 AMX Shannon X-Ray Station 1 & 2 J. David 1 2 3 4 5 6 7 Check Motor Issue DHR Install Gen. Housing Install Clips Install Term. Strip Install/Wire Latch Jumper Wire to Filter 10 20 30 40 50 60 70 80 90 74 T/T 3 2 10 5 6 4 10 3 2 5 4 6 4 6 30 40 X Step No. OperationName Time Manual Auto Travel ProductionReq'd Takt/Rate Time Manual Auto Travel Wait ~~~~~~~~ Organization Area Supervisor New / Rev Page of Date ProductionLine Part Number Part Name Operator Standard Work Combination Sheet Totals OperationTime Sec ( ) Min( ) Hr ( ) 1 1 2/6/02 AMX Shannon X-Ray Station 1 & 2 J. David 1 2 3 4 5 6 7 Check Motor Issue DHR Install Gen. Housing Install Clips Install Term. Strip Install/Wire Latch Jumper Wire to Filter 10 20 30 40 50 60 70 80 90 74 T/T 3 2 10 5 6 4 10 3 2 5 4 6 4 6 30 40 X Step No. OperationName Time Manual Auto Travel ProductionReq'd Takt/Rate Time Manual Auto Travel Wait ~~~~~~~~ Organization Area Supervisor New / Rev Page of Date ProductionLine Part Number Part Name Operator Standard Work Combination Sheet Totals OperationTime Sec ( ) Min( ) Hr ( ) 1 1 2/6/02 AMX Shannon X-Ray Station 1 & 2 J. David 1 2 3 4 5 6 7 Check Motor Issue DHR Install Gen. Housing Install Clips Install Term. Strip Install/Wire Latch Jumper Wire to Filter 10 20 30 40 50 60 70 80 90 74 T/T 3 2 10 5 6 4 10 3 2 5 4 6 4 6 30 40 X SCT=40 SCT=30 S t e p 1 S t e p 2 S t e p 3 S t e p 4 S t e p 5 Model 1 X X X X Model 2 X X X Model 3 X X X
  • 47.
    47 Rev 4 Feb 5th,04 Takt Build Time= # of Operations * Takt Actual Build Time =SCT 1 30 2 30 3 30 1 25 2 40 3 30 System TBT System ABT  1 -5 2 +10 3 0 System Objectives: Produce to Takt Time (understanding no 2 products will have the exact same ABT) • The sum of the DTot is zero • Every product is produced at least once • No product is produced twice in a row Create a product sequence where: Dtot = S(# of Units in sequence* D) Dtot = -5(# of 1’s)+10(# of 2’s)+0(# of 3’s) 0 = -5(2)+10(1)+0(1) According to the rules the sequence must run: System 1 – System 2 – System 1 – System 3
  • 48.
    48 Rev 4 Feb 5th,04 Takt Time Production Work Balancing Next Kaizen Focus
  • 49.
    49 Rev 4 Feb 5th,04 Stop @ Abnormality Takt Time Production Single Piece Flow Pull Production Autonomation Sequencing Level Loading JIT Jidoka Heijunka SPS The House of Solectron VSM, 5S, Supermarkets Adding Value and Eliminating Waste
  • 50.
    50 Rev 4 Feb 5th,04 Takt Time…The Heartbeat of the Business Available time Customer Forecast TAKT TIME = TAKT TIME is just Math, but is Fundamental to Lean AVAILABLE TIME: Total amount of TIME allocated for production DEMAND: qty of scheduled parts for a given time frame • each shift has ~ 6.5 hrs available - this is a constant! 6.5 hrs is used to account for lunches, breaks, etc... EXAMPLE Available Time = 60 min/hr x 6.5 hrs/shift x 2 shifts/day x 5 days/wk = 3900 min/wk Your customer demand is 90 pcs per week 3900 min/wk 90 pcs/wk = 43 min/pc TAKT Time =
  • 51.
    51 Rev 4 Feb 5th,04 Manpower Calculation Product Hourly Requirement Work Content Time TAKT Time System 1 4 units 25 min 5 min System 2 2 units 44 min 10 min System 3 2 units 30 min 10 min Total 8 units Weighted WCTime = 31min 7.5 min Line Staffing = Weighted Average Work Content Time Takt Time [ (4/8) *25] + [(2/8)*44] + [(2/8)*30] 7.5 min /pcs = = 4.13 Kaizen Example: 4
  • 52.
    52 Rev 4 Feb 5th,04 Work Balance Time Person A B D C Time Person Takt/Time A B D 64” C Bottleneck Wasted Time / Waiting
  • 53.
    53 Rev 4 Feb 5th,04 What We’re Striving For … Time Person A B D C Time Person Takt/Time A B D 64” C Bottleneck Reduce Wasted Time / Waiting Balanced Operations… Station by Station…Line by Line
  • 54.
    54 Rev 4 Feb 5th,04 Single Piece Flow Std Work 3P (Production Prep Process)
  • 55.
    55 Rev 4 Feb 5th,04 Stop @ Abnormality Takt Time Production Single Piece Flow Pull Production Autonomation Sequencing Level Loading JIT Jidoka Heijunka SPS The House of Solectron VSM, 5S, Supermarkets Adding Value and Eliminating Waste
  • 56.
    56 Rev 4 Feb 5th,04 JIT Jidoka Heijunka SPS Stop @ Abnormality Takt Time Production Single Piece Flow Pull Production Autonomation Sequencing Level Loading The House of Solectron VSM, 5S, Supermarkets Adding Value and Eliminating Waste
  • 57.
    57 Rev 4 Feb 5th,04 Do Not Make Defects Do Not Pass Along Defects Do Not Accept Defect Defects are the Worst Kind of Waste Single Piece Flow is intended to detect defects as they occur 3 Things to Remember … Single Piece Flow 7 Types of Waste • Defective Parts • Over Production • Inventory • Motion • Transportation • Waiting • Over Processing
  • 58.
    58 Rev 4 Feb 5th,04 Building Quality into the Process The Next Process is the Customer … Never Send Defects ! Catches Defects too Late • How many more do you have? • Where are they in the process? • What is the root cause? Catches Defects Immediately • You only have one • You know where it occurred • Resolve the root cause immediately Batch Single Piece Flow From: The Solectron Production System
  • 59.
    59 Rev 4 Feb 5th,04 Single Piece Flow Guidelines for Cell Layout Good Cell Layout Makes Work Redistribution Easy  Place Workstations Close Together to Minimize Walking Distance  Keep Inside Width of a Cell at 5 feet to Allow Flexibility in Work Redistribution  Locate the Leadoff and Final Processes Near one Another  Eliminate Spaces and Surface where WIP can Accumulate  Use Dedicated Hand Tools and Gravity to Assist Operators  Absolutely ensure Safety and Good Ergonomics  5S Materials Machines Cell Layout
  • 60.
    60 Rev 4 Feb 5th,04 Materials Machines Cell Layout Single Piece Flow Guidelines for Machine Good Machine Design Enables Operator Focus on Manual Content  Use small equipment dedicated to a single task  Introduce Auto-Eject When Operators Must Use Both Hands  Install One-Touch Automation Where Possible  Incorporate Sensors to Signal Abnormal Conditions, so Operators Do not Need to Watch Machines During Cycle  Avoid Batching  At Pacemaker, Strive to Devise Machine Changeover Between Different Assemblies Take Less than 1 TAKT Cycle
  • 61.
    61 Rev 4 Feb 5th,04 Single Piece Flow Guidelines for Materials Good Material Flow Improves Productivity  Present Parts as Close as Possible to the Point of Use  Present Parts so Operators can use Both Hand Simultaneously  Do not Have Operators Get or Restock Their Own Parts  Keep No More than 2 Hours of Material at the Point of Use  Do not Put Additional Parts Storage in or Near the Process  Utilize Kanban to Regulate Parts Replenishment  Size Part Bin for the Convenience of the Operator, Not for the Convenience of the Material Handler or Supplying Process Materials Machines Cell Layout
  • 62.
    62 Rev 4 Feb 5th,04 Single Piece Flow 18’ 14’ Assembly I Connector Preparation Assembly II angled to keep cell Inside Width about 5’ Parts & materials presented on Flow racks from outside cell Single piece of in-process stock left In machine as operator moves on No obstruction in walking path No space for WIP accumulation Assembly IV angled to bring cell start And end together I 30 pcs /Container Example Result : 5 Pieces in Process
  • 63.
    63 Rev 4 Feb 5th,04 Standard Work
  • 64.
    64 Rev 4 Feb 5th,04 JIT Jidoka Heijunka SPS Stop @ Abnormality Takt Time Production Single Piece Flow Pull Production Autonomation Sequencing Level Loading The House of Solectron VSM, 5S, Supermarkets Adding Value and Eliminating Waste
  • 65.
    65 Rev 4 Feb 5th,04 What is Standard Work? Standard Work is a combination of actions performed by humans and machines carrying out value-added work in an efficient way in the right sequence & right time, enabled by material & information flow, using the right tools as required. It is the foundation for a lean enterprise. (1) TAKT Time (2) Work sequence (order of operations) (3) Standard work-in-process Standard Work Definition Three Elements of Standard Work
  • 66.
    66 Rev 4 Feb 5th,04 Why Have Standard Work? (1) To make manufacturing rules explicit Establish the methods for manual tasks with respect to safety, quality, quantity and cost. (2) A tool for KAIZEN Establish baseline for future improvement Standard Work - Objective There Is No Improvement In The Absence Of Standards
  • 67.
    67 Rev 4 Feb 5th,04 (1) Human motions must be central to the operation (2) The Operation must be repetitive (3) “Blue print” for how the shop should run Variation = Risk Of Poor Quality Elements of Standard Work
  • 68.
    68 Rev 4 Feb 5th,04 TAKT Time The Heartbeat of the Business 1st Element of Standard Work Standard WIP Work Sequence TAKT Time 4 1 Available time Customer Forecast TAKT TIME = TAKT TIME is just Math, but is Fundamental to Lean AVAILABLE TIME: Total amount of TIME allocated for production DEMAND: qty of scheduled parts for a given time frame • each shift has ~ 6.5 hrs available - this is a constant! 6.5 hrs is used to account for lunches, breaks, etc... EXAMPLE Available Time = 60 min/hr x 6.5 hrs/shift x 2 shifts/day x 5 days/wk = 3900 min/wk Your customer demand is 90 pcs per week 3900 min/wk 90 pcs/wk = 43 min/pc TAKT Time =
  • 69.
    69 Rev 4 Feb 5th,04 Work Sequence The order of operations in which a worker places parts on a machine or in an assembly. The Same Thing, The Same Way, Every Time 4 2 Standard WIP Work Sequence TAKT Time machine processing       2nd Element of Standard Work
  • 70.
    70 Rev 4 Feb 5th,04 Standard Work-in-Process (SWIP) Refers to the minimum work-in-process needed to perform repetitive operations,  parts mounted on machines  parts on conveyors  parts needing time to cool, etc. One Piece Is The Standard Goal TAKT Time Standard WIP Work Sequence 4 3 End Finish Weld End Finish Weld Orbital Weld Hydro Test Mark Mech. Clean Torch Braze Mech. Clean Flex 3rd Element of Standard Work
  • 71.
    71 Rev 4 Feb 5th,04 Gaining Capacity a) Understand the current situation (Document Work Sequence…Order of Operations) b) Measure times for workers A, B, C and D c) Redistribute all waiting times (to D) Time Person T / T A B C D 60” (51”) (45”) (58”) (43”) Time Person T / T A B D 60” (60”) (60”) (60”) (12”) C To Improve, you need only 12” reduction (Eliminate the work of Worker D) Improvement Via Standard Work ” means seconds
  • 72.
    72 Rev 4 Feb 5th,04 Carry out individual Kaizen and balance out the tasks on the basis of standard operations for workers A, B, C, and D. Any waste in walking from one work station to another? look at how parts are placed and the positions of operation tables Operational variability… look for any unreasonable postures and movements Hand movements … look at how parts are placed and the location of start buttons Improvements … determine whether the net time can be shortened; resolve the imbalances Kaizen T / T A B C D 60” (60”) (60”) (60”) (12”) By eliminating MUDA Improvement Via Standard Work Eliminating Waste
  • 73.
    73 Rev 4 Feb 5th,04 Enhancing Production Capacity How to increase production capacity machine processing MANUAL AUTOMATED 2 min for completion       1 minute 1 minute Improvement Via Standard Work
  • 74.
    74 Rev 4 Feb 5th,04       1 minute 1 min 30 sec for completion  Beginning of automated cycle change 1 min 30 sec for completion 30 second Reduction Rearrange sequence of operation Enhancing Production Capacity Improvement Via Standard Work
  • 75.
    75 Rev 4 Feb 5th,04  Standard work is the starting point for shop-floor KAIZEN; without standards there is no KAIZEN.  Humans should always be working at TAKT.  A standard work is not written in stone. It is continually revised based on KAIZEN and changes in production volume. Roadmap To Standard Work Review of Standard Work
  • 76.
    76 Rev 4 Feb 5th,04 Tools for Standard Work Time Measurement Sheet Capacity Sheet Combination Table Standard Work Chart Work Instruction
  • 77.
    77 Rev 4 Feb 5th,04 Time Measurement Sheet
  • 78.
    78 Rev 4 Feb 5th,04 Capacity Sheet
  • 79.
    79 Rev 4 Feb 5th,04 Step No. Operation Name Time Manual Auto Travel Production Req'd Takt/Rate Time Manual Auto Travel Wait ~~~~~~~~ Organization Area Supervisor New / Rev Page of Date Production Line Part Number Part Name Operator Standard Work Combination Sheet Totals Operation Time Sec ( ) Min ( ) Hr ( ) Enter the travel time Enter the unit of measured time Enter Any machine Automatic Run Time. This operation! Enter the Any Manual Time (Hands On) Enter the operation Name Screen Print One sheet per Operator!!! x 5 35 5 T/T 5 10 15 20 25 30 35 1 3.9 min 1 2 SMT 10 0 2 3 Reflow 10 8 4 wait 0 0 0 Op/Step numbers 4 25 73 10 Process Capacity Sheet Data 1/09/03 Sun RU18P03 PCBA Board A 1 1 1000 Standard Work Combination Table Harjinder Bajwa
  • 80.
    80 Rev 4 Feb 5th,04 Organization Area Supervisor New / Rev Page of Date Production Line Part Number Part Name Operator Standard Work Sheet To: Turns DPU's Scope of Operations From: Quality Check Safety Precaution Standard Work-in-Process # Lots of Standard Work-in-Process Takt/Rate Time Total Manual & Travel Time Man/Travel Time Operator Inspection Wave Hand Load Connector Stage Test Mark Stage Touch Up PCBA Bldg 3 Harjinder Bajwa 1 All Parts Sun PCBA 1 1 Clean Raw material Configure 100/Day ICT 5DX Funt Test 2nd Qtr. ‘04 Pack Outside Cell 27 - avg lot = 6 Flex Finished Goods Standard Work Chart
  • 81.
    81 Rev 4 Feb 5th,04 Work Instruction
  • 82.
    82 Rev 4 Feb 5th,04 Work forms should be located in each work area 1 2 3 6 5 4 • Work Capacity • Combination Table • Work instructions • Standard Work Charts World-class work typically have a binder at each workstation with work forms and process instructions (e.g., part drawings, engineering instructions, descriptions of final use). Work capacity and combination table are visually posted because they are real problem-solving forms used on a continuous basis Work Instruction
  • 83.
    83 Rev 4 Feb 5th,04 3P (Production Preparation Process) Managed Creativity
  • 84.
    84 Rev 4 Feb 5th,04 Tools for 3P 7 Designs 7 Ways Pugh Matrix Golf Score Sheet
  • 85.
  • 86.
    1 2 34 5 6 7 Process Method Jig / Fixture Hand Tool No-Go Gage Poke - Yoke Machine 7 ways For Each Process Part Process Sketch Quality Requirements 7 Ways
  • 87.
    Operation 10 2030 40 50 60 70 80 90 100 110 120 130 140 150 160 Sum 1 Meet Takt Time 2 One Piece Flow 3 Min. Oper. Involement ( Load / Start ) 4 Hanedashi 5 Chaku - Chaku 6 Poke Yoke 7 Min. Capitol Required 8 100% Gaging 9 Value Adding Operation 10 Smed 11 No Tool Room Maintenance 12 Tooling Cost + 30% 13 3D ( Dangerous, Dirty, Difficult ) 14 As Simple As Possible 15 Readily Available Equipment 16 6 Sigma Process Capaility 17 Known Process To GE 18 Future Challenge 19 Maintenance Free Machines 20 Technology Familiar To GE 21 Jidoka 22 Min. Time To Develop OVERALL PROCESS RATING Rating: 5 - Excellant 4 - Above Average 3 - Average 2 - Below Average 1 - Poor 0 - N/A Process Evaluation Pugh Matrix
  • 88.
    88 Rev 4 Feb 5th,04 SCORE DESCRIPTION OPERATION COUNTER HAND-AS- FIXTURE ADDER (+10) AWKWARD HEIGHT ADDER (+10) 1 Operation done in a downward motion. 3 Operation done in a sideways motion. 10 Operation done in a upward motion. 100 Operation done in non-visible location Place a 1 in the "Operation Counter" each time an operation is completed as described. The count of all 1's should equal the total number of operations. Also place 1's in the "Adder" columns as appropriate for a specific operation. These will adjust the total score. Example: if an operation is done in a sideways motion, put a 1 in the Operation Counter section for a 3 point score. If an operation is done in a sideways motion at an awkward height, put a 1 in the Operation Counter for a 3 point score, and a 1 in the Awkward Height Adder column. The total points for that 1 operation then is 13. Assembly Golf Score Golf Score Tool
  • 89.
    89 Rev 4 Feb 5th,04 Pull Production
  • 90.
    90 Rev 4 Feb 5th,04 JIT Jidoka Heijunka SPS Stop @ Abnormality Takt Time Production Single Piece Flow Pull Production Autonomation Sequencing Level Loading The House of Solectron VSM, 5S, Supermarkets Adding Value and Eliminating Waste
  • 91.
    91 Rev 4 Feb 5th,04 • Withdraws needed parts from preceding process • Preceding process “owns” Supermarket • “Purchasing” intervals derived from TAKT time • “Purchased” quantities in standardized amounts Tenants of Pull Consume Before Bringing More Material In
  • 92.
    92 Rev 4 Feb 5th,04 1 2 End Finish Weld End Finish Weld Orbital Weld Hydro Test Mark Mech. Clean Torch Braze Mech. Clean Flex End Finish Weld End Finish Weld Orbital Weld Hydro Test Mark Mech. Clean Torch Braze Mech. Clean Flex 3 4 Cell or Chaku-Chaku line Parts 7 8 9 10 End Finish Weld End Finish Weld Orbital Weld Hydro Test Mark Mech. Clean Torch Braze Mech. Clean Flex End Finish Weld End Finish Weld Orbital Weld Hydro Test Mark Mech. Clean Torch Braze Mech. Clean Flex Supplier Material Information Supermarket Empty container Full container Legend 1 Sequence / Timing Pull Methodology & Sequence Assembly Line 5 6
  • 93.
    93 Rev 4 Feb 5th,04 JIT Jidoka Heijunka SPS Stop @ Abnormality Takt Time Production Single Piece Flow Pull Production Autonomation Sequencing Level Loading The House of Solectron VSM, 5S, Supermarkets Adding Value and Eliminating Waste
  • 94.
    94 Rev 4 Feb 5th,04 Kanban System
  • 95.
    95 Rev 4 Feb 5th,04 • Circulation of Information • Cards are Like $ Used to “Buy” Parts from the Supermarket • Tool Used in Pull Production Basics of The Kanban System Kanban is Not Material . . . It is Information
  • 96.
    96 Rev 4 Feb 5th,04 There are 4 conditions that need to be met before you can introduce the Kanban effectively… 1. Stability of Preceding Process in Quality and Productivity 2. Leveled Production 3. Takt Production / Pull System 4. Team Member Education Prerequisites of The Kanban System Kanban Can Paralyze Without Satisfying These Conditions
  • 97.
    97 Rev 4 Feb 5th,04 • Physical Goods Control: Movement of Kanban corresponds to physical goods • Instruction of Operation: What do you produce and how many? • Tool for Kaizen: Easier to see material deficiencies Roles of Kanban The Chain of Kanbans Spans From Customers to Suppliers
  • 98.
    98 Rev 4 Feb 5th,04 Types of Kanban 6 Types of Kanban can be classified as follows: 1. Production Kanban Specifies the type and quantity in which the previous process has to produce the product. 2. Withdraw Kanban Specifies the address where the parts need to go. Each Type for Specific Points in the Process Kanban Production Kanban In-Process Kanban Signal Kanban Inter-Process Kanban Supplier Kanban Withdraw Kanban
  • 99.
    99 Rev 4 Feb 5th,04 Example of In-Process Kanban Kanban Gives Instruction for the Process to Produce In-Process Kanban The card is pulled from the containers to start the reorder “only” when The first part in the container is used
  • 100.
    100 Rev 4 Feb 5th,04 Example of Signal Kanban Overproduction is the Mother of all Waste Qty/ Pallet 54 Pallet Reorder QTY 6 Part Number 87EFGT3457AH Component Name Front Bracket L/H Line Number L16 Lot Size 540 Reorder QTY 270 The card is placed when parts are withdrawn at the re-order point Signal Kanban
  • 101.
    101 Rev 4 Feb 5th,04 Example of Kanban Signal Kanban is Used when Changeover Time is Long In-Process Kanban Signal Kanban Reorder Point Stocking Height should not exceed the visual line for safety reason
  • 102.
    102 Rev 4 Feb 5th,04 Rules of Kanban System Kanban is a Forcing Function to Reduce Overproduction  Defective Parts Must not be Passed on  The Consuming Process Comes to Withdraw Parts  Produce to Replenish Only What is Withdrawn  Parts Must not be Produced or Conveyed Without Kanban  Kanban Must be Attached to the Parts or Container  The Quantity of Parts in the Container Must Match Exactly the Number on the Kanban Withdrawal Kanban Production Kanban Kanban System
  • 103.
    103 Rev 4 Feb 5th,04 Rules of Production Kanban Kanban is not Effective if the Rules are not Followed  Quantity of Parts Produced Must Equal the Quantity of Parts Withdrawn  Quantity Listed on Kanban Must Equal the Quantity Per Container  Kanban Must be Attached and Visible on the Part Container  Parts Must Remain in Stores at the Production Process Until Withdrawn by the Following Process Withdrawal Kanban Production Kanban Kanban System
  • 104.
    104 Rev 4 Feb 5th,04 Rules of Withdrawal Kanban Discipline Required to Implement Kanban Systems  Parts Must be Picked up from the Preceding Process  Parts are not to be Withdrawn Without a Kanban  Quantity of Parts Withdrawn Must Equal the Number of Parts Ordered by the Kanban  The Withdrawal Kanban Must be Attached to the Parts Withdrawn so That it is Visible  The Parts Withdrawn Must be Put in the Designated Area at the Following Process Withdrawal Kanban Production Kanban Kanban System
  • 105.
    105 Rev 4 Feb 5th,04 Kanban Summary • High-Level Tool • Many Problems to Solve Before Implementing • Install After You’ve Perfected Pull • Kanban is Information not Material
  • 106.
    106 Rev 4 Feb 5th,04 Dec.12.2003(PART-2) IBARAKI KANBAN System (Pull Production System) Rev.2 Dec.12.2003
  • 107.
    107 Rev 4 Feb 5th,04 1. Outline of KANBAN System 2. High Mix Low Volume Production 3. Layout Image of Server Biz 4. KANBAN Stream 5. KANBAN Types 6. KANBAN Samples 7. Role of WATER SPIDER 8. Activities of WATER SPIDER --Please go and watch “Our (Ibaraki) Lean Lines”-- Contents
  • 108.
    108 Rev 4 Feb 5th,04 (Supply Chain) Minimum Parts stock 1. Outline of ”KANBAN System " Benefits - High Customer Satisfaction High - Product Quality / Reliability -Minimum Inventory (PO/Delivery) Daily PO/Delivery Minimum customer stock Configuration Test Software Delivery Commitment End User PO(Configuration) S I Service Customer Monitor, UPS Peripherals PO to Shipment :4~6days Parts (Production) Manufacturing BTO/CTO products Plug & Play Supplier Options Manuf acturi ng Completed System Delivery
  • 109.
    109 Rev 4 Feb 5th,04 Logistic Network Small volume & Frequent Parts and Products Delivery Possibility to direct Delivery for End User Kanazawa Niigata Sapporo Kagoshima Yamaguchi Sendai Yamagata Koriyama Osaka Takamats u Nagano Nagoy a Shizuok a Kofu Akita Morioka Tokyo SLR-Ibaraki Daily network figure in Japan Fukuoka Kumamoto Hiroshima
  • 110.
    110 Rev 4 Feb 5th,04 2. High Mix Low Volume Production SMT (2 line) Box Build POST SMT Supplier 1time/day Frequency 24hrs 20mins 20mins 20mins 20mins 2hrs Board Assembly 4times/day Box W/H Board W/H FGS PO(Configuration) Customer Lot size less than 20pcs 80% 1Pc 1Unit Kind/day 60 130 200(Box) 1,000(Option) Q’ty/Mth 14,000 14,000 4,300(Box) 20,000(Option)
  • 111.
    111 Rev 4 Feb 5th,04 Option HDD Test Option HDD/Board Unit Ass'y/Packing(A,B,C,D Line) Unit Test (A,B,C,D Line) Material Store Raw material Material Product Flow Shipping Shipping Material Store SMT B Line Material Store Material Store POST SMT PCBA Store Kanban for Procurement SMT Store Off- Line Prep. Receiving Dock BOX PCBA SMT C Line SMT D Line SMT A Line 〒 〒 〒 〒 〒 3. Layout Image of Server Biz PCBATest 〒 KANBAN Post POST SMT AOI AOI
  • 112.
    112 Rev 4 Feb 5th,04 Option HDD Test Option HDD/Board Unit Ass'y/Packing(A,B,C,D Line) Unit Test (A,B,C,D Line) Material Store Shipping Shipping Material Store SMT B Line Material Store Material Store PCBA Store Kanban for Procurement SMT Store Off- Line Prep. Receiving Dock BOX PCBA SMT C Line SMT D Line SMT A Line 〒 〒 〒 〒 〒 PartsPrep. PartsPrep. 4. KANBAN Stream (A)KANBAN (D)KANBAN (B)KANBAN (C)KANBAN Raw material KANBAN+Material Only KANBAN 〒 KANBAN Post PCBATest AOI POST SMT AOI POST SMT
  • 113.
    113 Rev 4 Feb 5th,04 (MIN) 1 2 3 4 5 6 7 8 9 10 11 12 13 14 15 16 17 18 19 20 Process Description PCBA-Store Collecting Kanban SMT-Store Shipping Collecting Kanban SMT-Visual Inspection Supply/Delivery SMT-Inspection Delivery Masking Supply Hand loading Supply SMT-Store OUT W/H SMT SMT Input Box for collecting kanban Wave Solder Delivery Selective Solder Supply/Delivery Manual Solder2/QA Supply Manual Solder1 Supply/Delivery Modeification Supply/Delivery Press Fit Supply/Delivery Manual Solder2/QA Supply/Delivery ICT Supply/Delivery PCBA-Store IN W/H Start End Start One Water Spider activity Activities of WATER SPIDER(B)KANBAN
  • 114.
    114 Rev 4 Feb 5th,04 Pull KANBAN Pull KANBAN for Inter-process Delivery KANBAN (Supplier KANBAN) Definition : Instruction KANBAN – Instruct the production Pull KANBAN – Instruct to pull from pre-process only the post-process used quantities. Instruction KANBAN Intra-process KANBAN 5. KANBAN Types Example (Ibaraki) A,B,C A,B D
  • 115.
    115 Rev 4 Feb 5th,04 6. KANBAN Samples (A) --Instruction/Pull KANBAN(Box Build)--
  • 116.
    116 Rev 4 Feb 5th,04 6. KANBAN Samples (B)-- Instruction/Pull KANBAN(Post SMT) --
  • 117.
    117 Rev 4 Feb 5th,04 6. KANBAN Samples (C)-- Instruction KANBAN(SMT) --
  • 118.
    118 Rev 4 Feb 5th,04 6. KANBAN Samples (D)-- Delivery KANBAN (Supplier) --
  • 119.
    119 Rev 4 Feb 5th,04 1) Production Instruction -Instruct production to each process. 2) Delivery -Supply parts to each process -Supply WIP to next process 7. Role of WATER SPIDER
  • 120.
    120 Rev 4 Feb 5th,04 8. Activities of WATER SPIDER -- Please go and watch “Our (Ibaraki) Lean Lines” --
