SFU Cascading with Janus
Lorenzo Miniero
@elminiero
IIT Real-Time Communication 2022 – WebRTC Track
October 11th 2022, Chicago, IL, USA
A few words about me
Lorenzo Miniero
• Ph.D @ UniNA
• Chairman @ Meetecho
• Main author of Janus®
Contacts and info
• lorenzo@meetecho.com
• https://twitter.com/elminiero
• https://www.slideshare.net/LorenzoMiniero
• https://lminiero.bandcamp.com
A quick reminder on what Janus is!
Janus
General purpose, open source WebRTC server
• https://github.com/meetecho/janus-gateway
• Demos and documentation: https://janus.conf.meetecho.com
• Community: https://groups.google.com/forum/#!forum/meetecho-janus

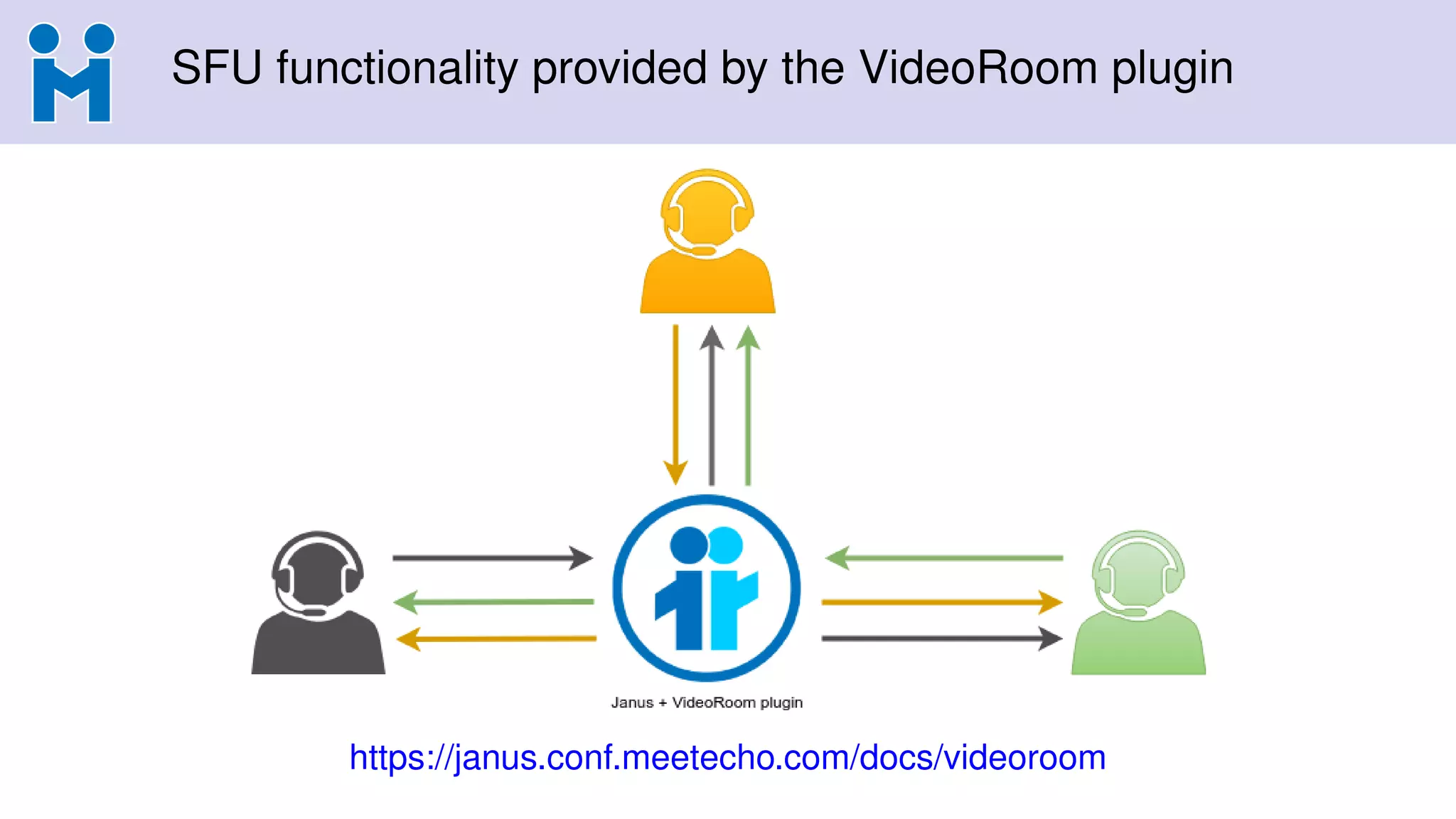

SFU functionality provided by the VideoRoom plugin
https://janus.conf.meetecho.com/docs/videoroom
Historically, different ways to scale Janus (and VideoRoom)
https://www.slideshare.net/LorenzoMiniero/scaling-webrtc-applications-with-janus

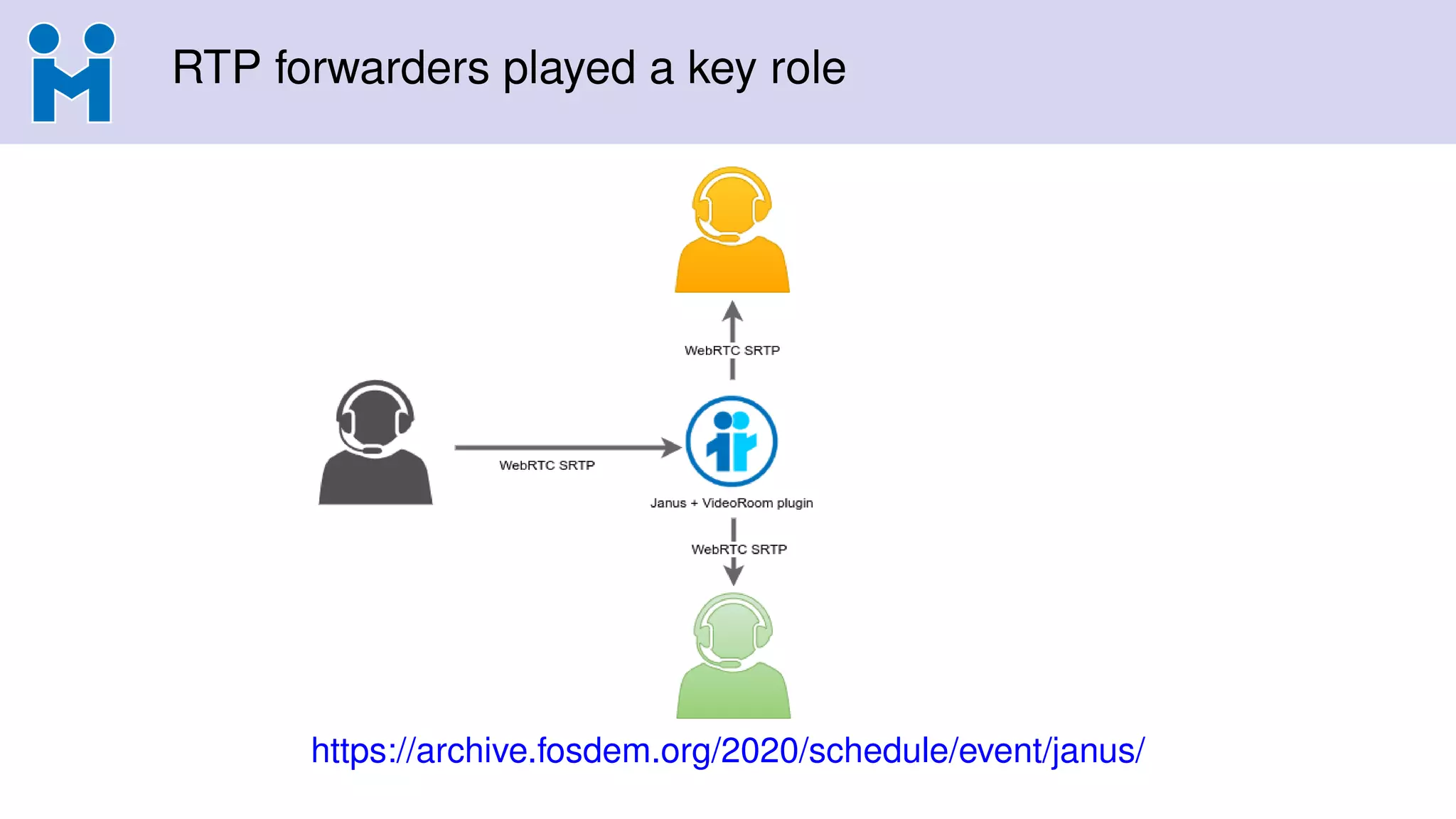

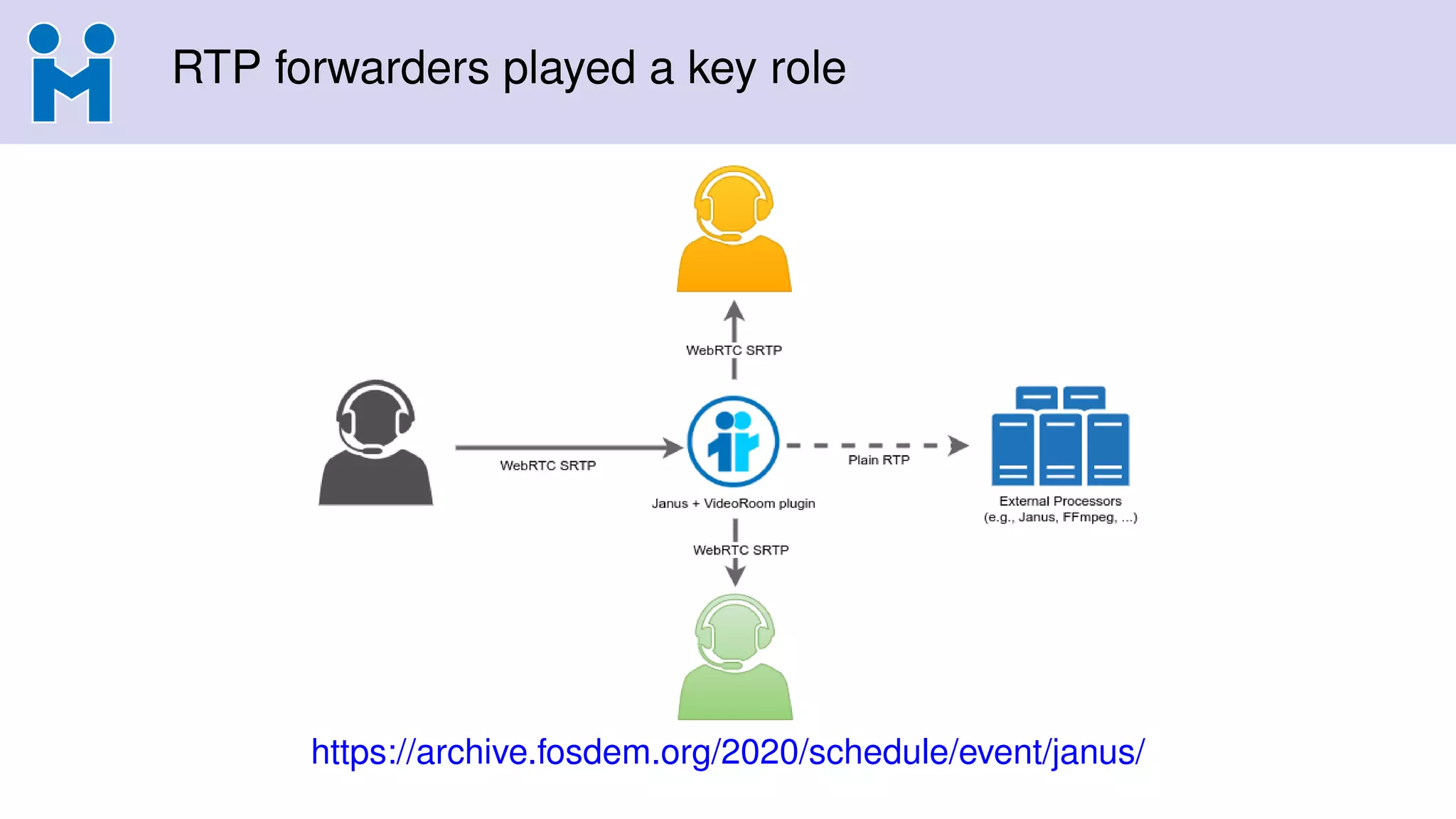

RTP forwarders played a key role

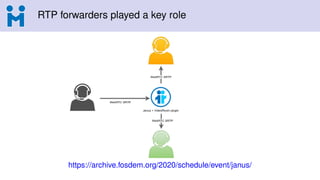

https://archive.fosdem.org/2020/schedule/event/janus/
RTP forwarders played a key role
https://archive.fosdem.org/2020/schedule/event/janus/

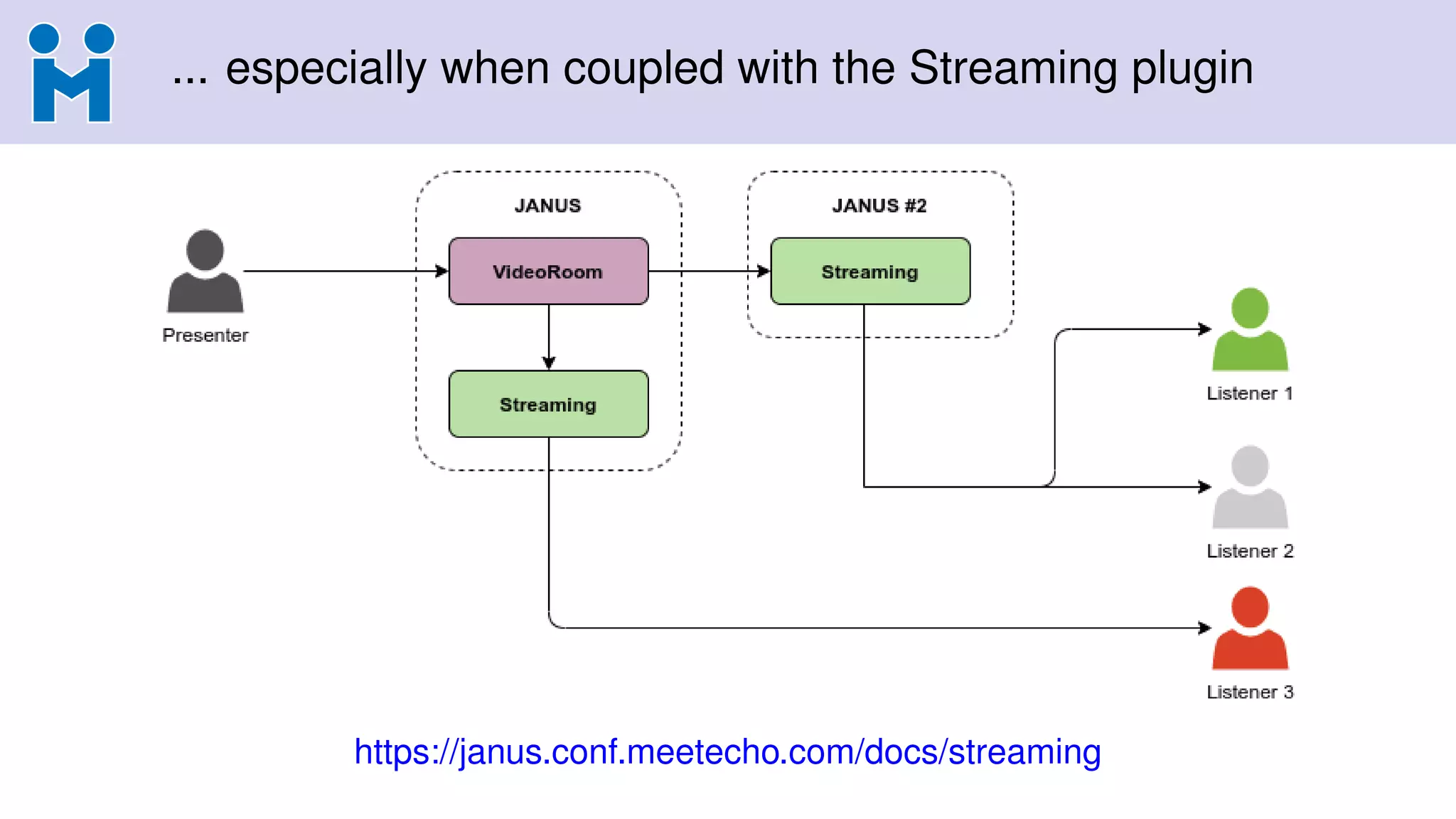

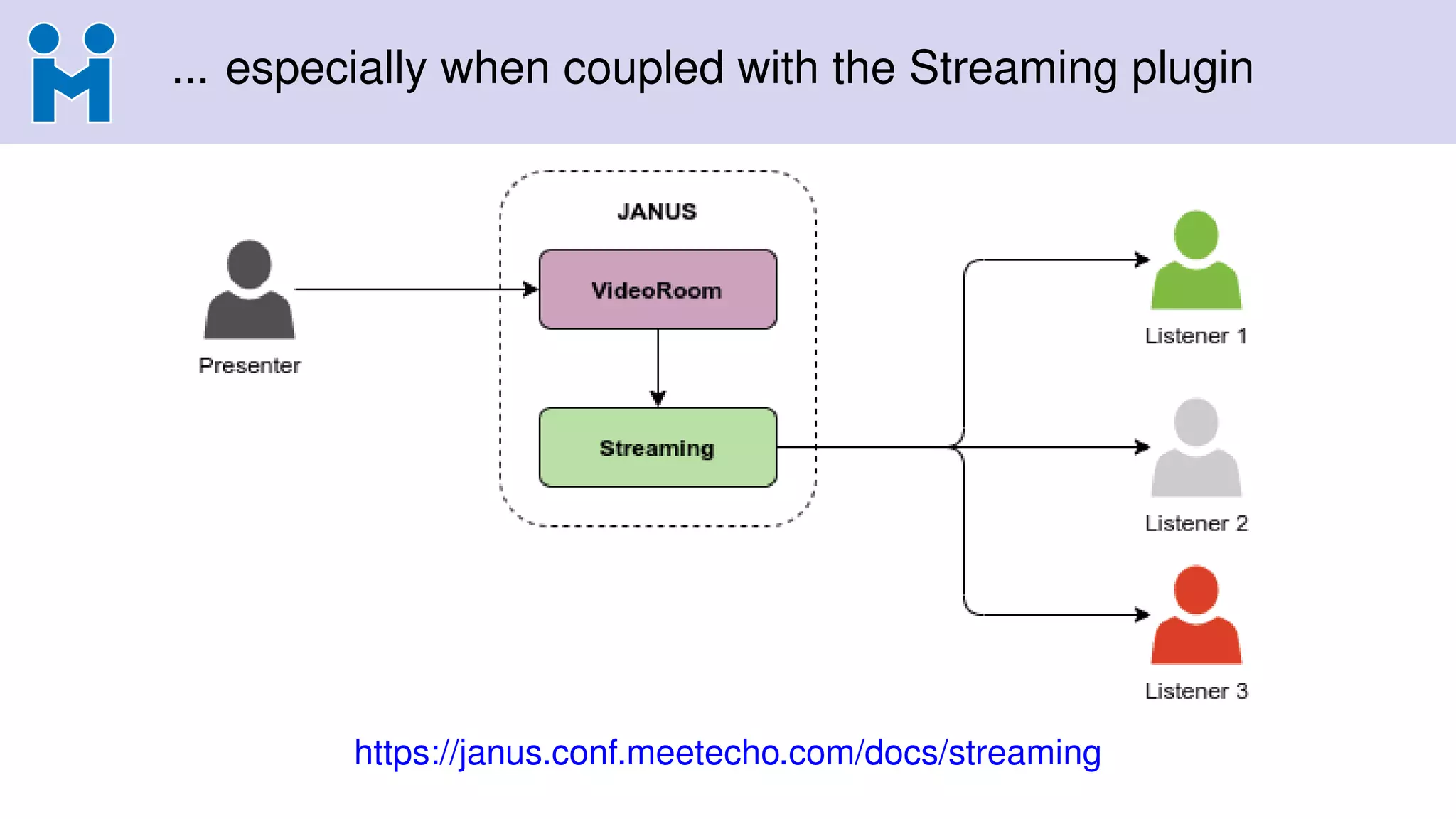

... especially when coupled with the Streaming plugin
https://janus.conf.meetecho.com/docs/streaming
... especially when coupled with the Streaming plugin
https://janus.conf.meetecho.com/docs/streaming
... especially when coupled with the Streaming plugin
https://janus.conf.meetecho.com/docs/streaming

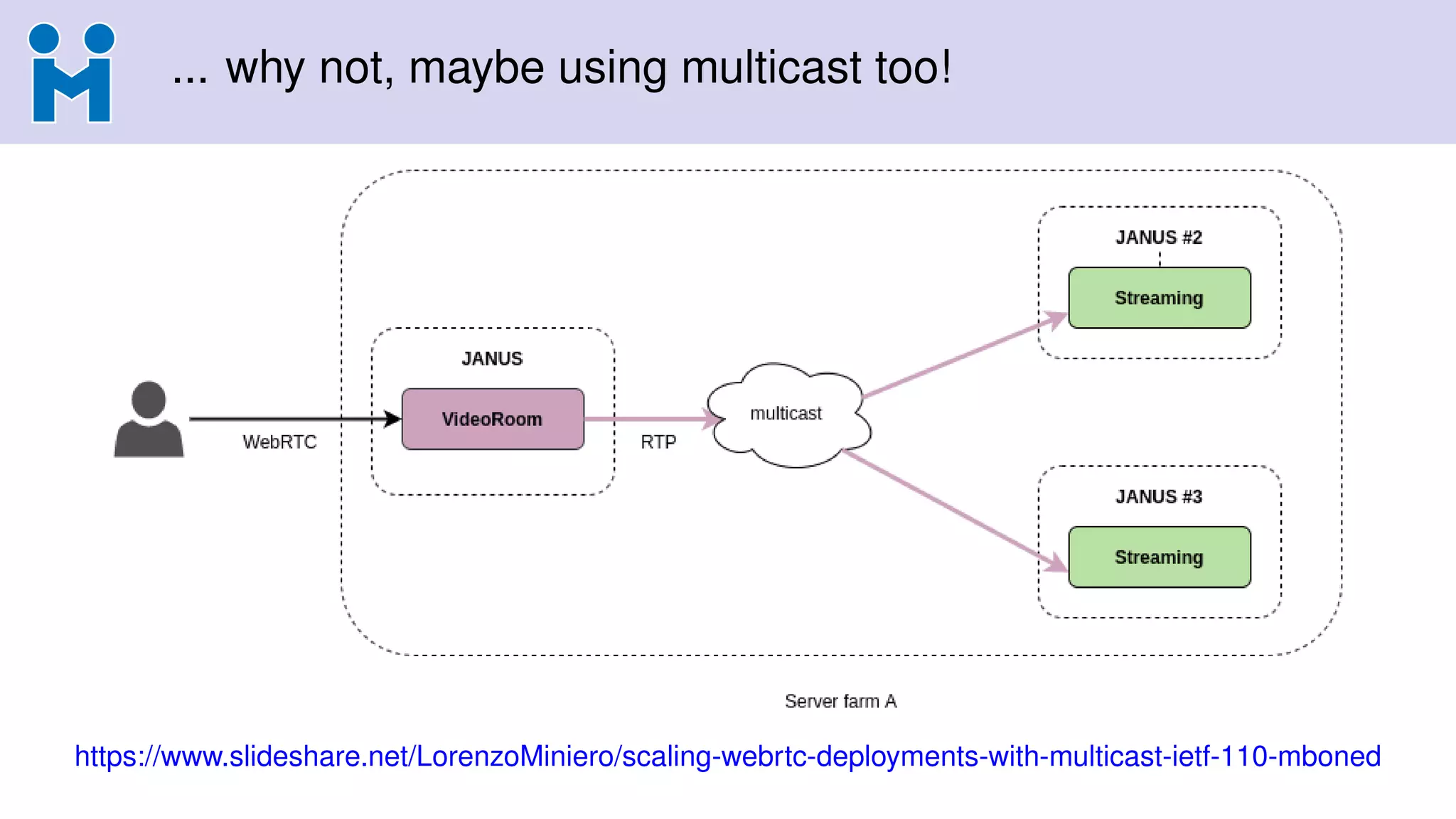

... why not, maybe using multicast too!
https://www.slideshare.net/LorenzoMiniero/scaling-webrtc-deployments-with-multicast-ietf-110-mboned

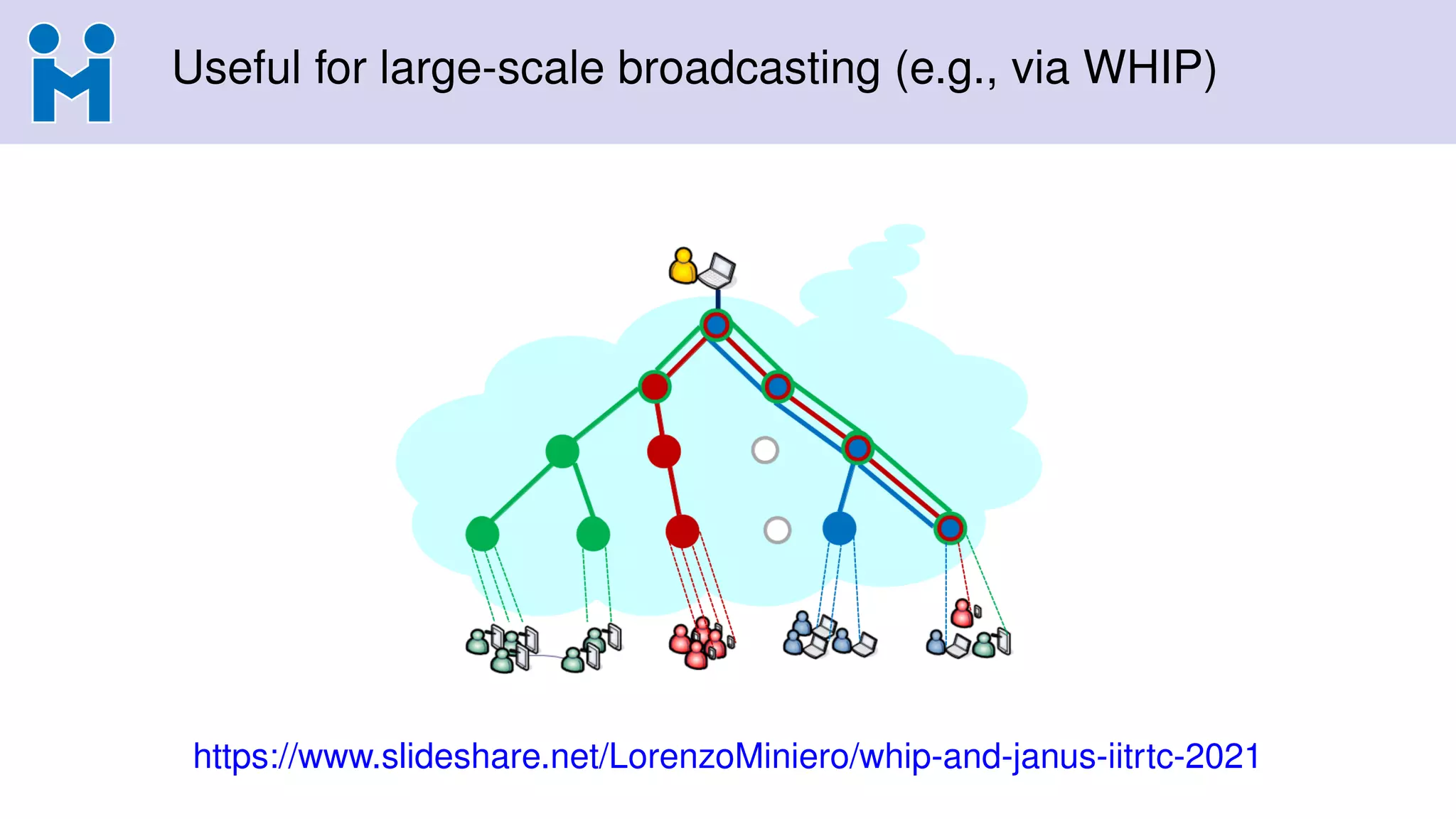

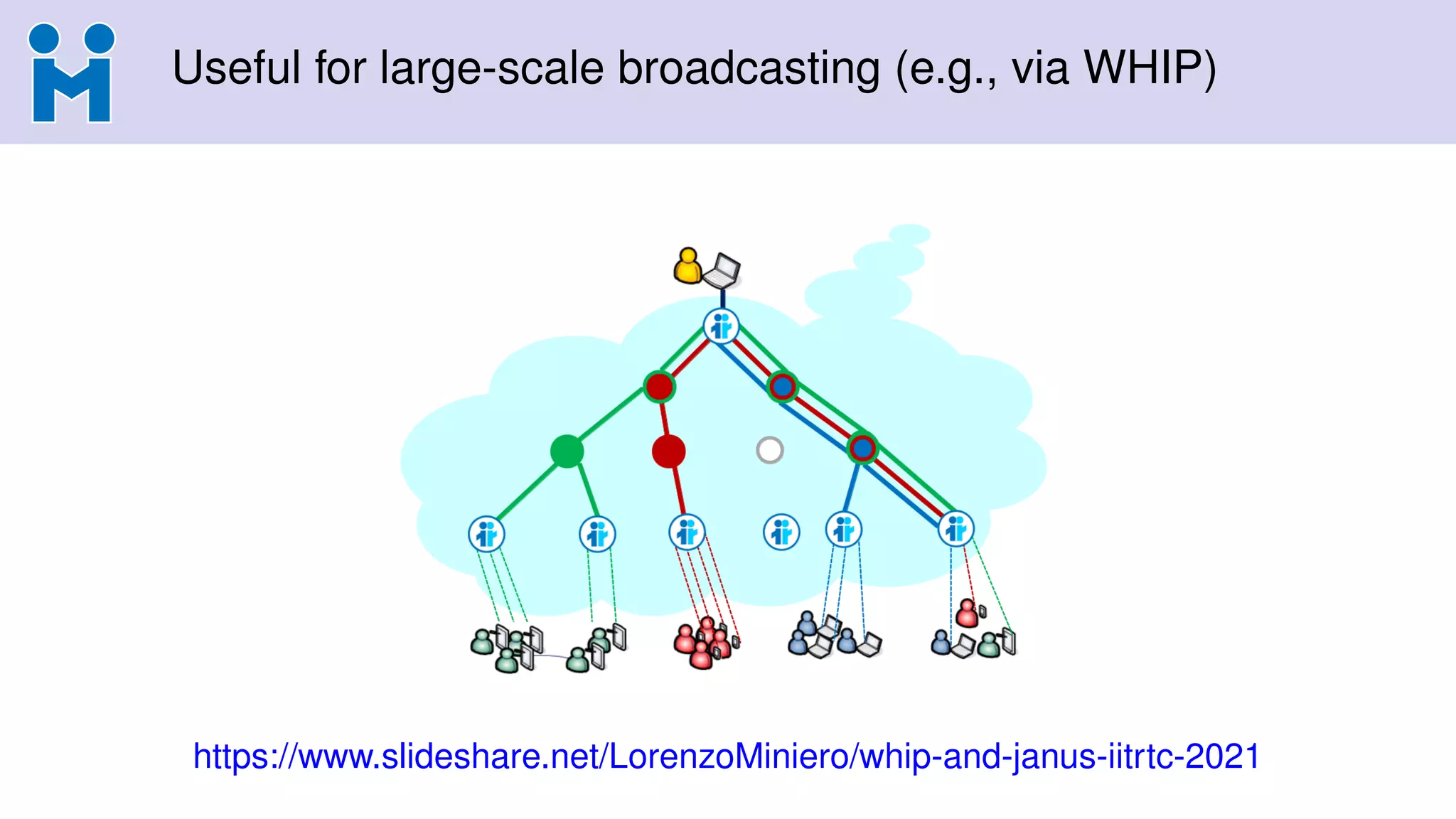

Useful for large-scale broadcasting (e.g., via WHIP)
https://www.slideshare.net/LorenzoMiniero/whip-and-janus-iitrtc-2021
Useful for large-scale broadcasting (e.g., via WHIP)
https://www.slideshare.net/LorenzoMiniero/whip-and-janus-iitrtc-2021

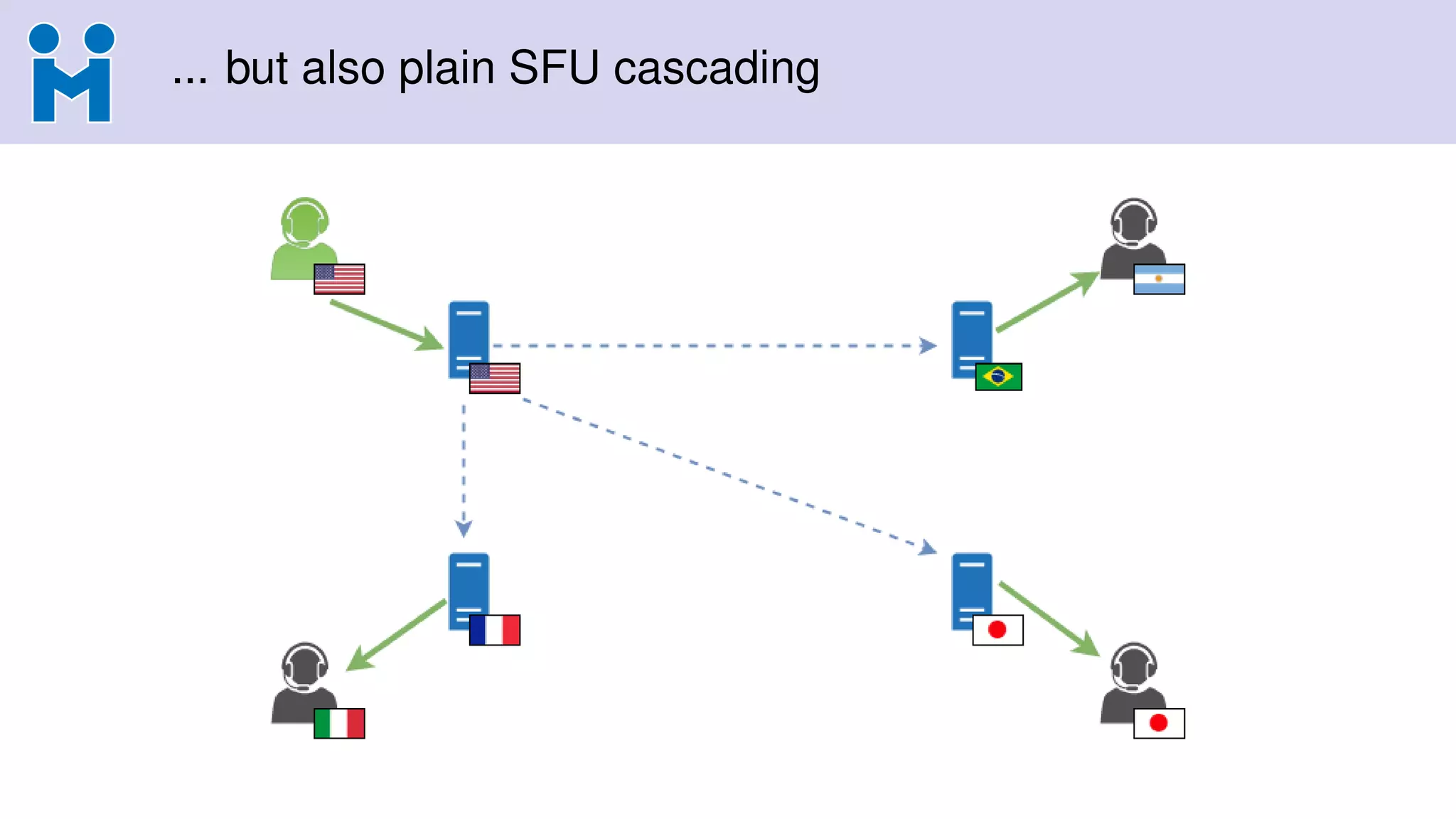

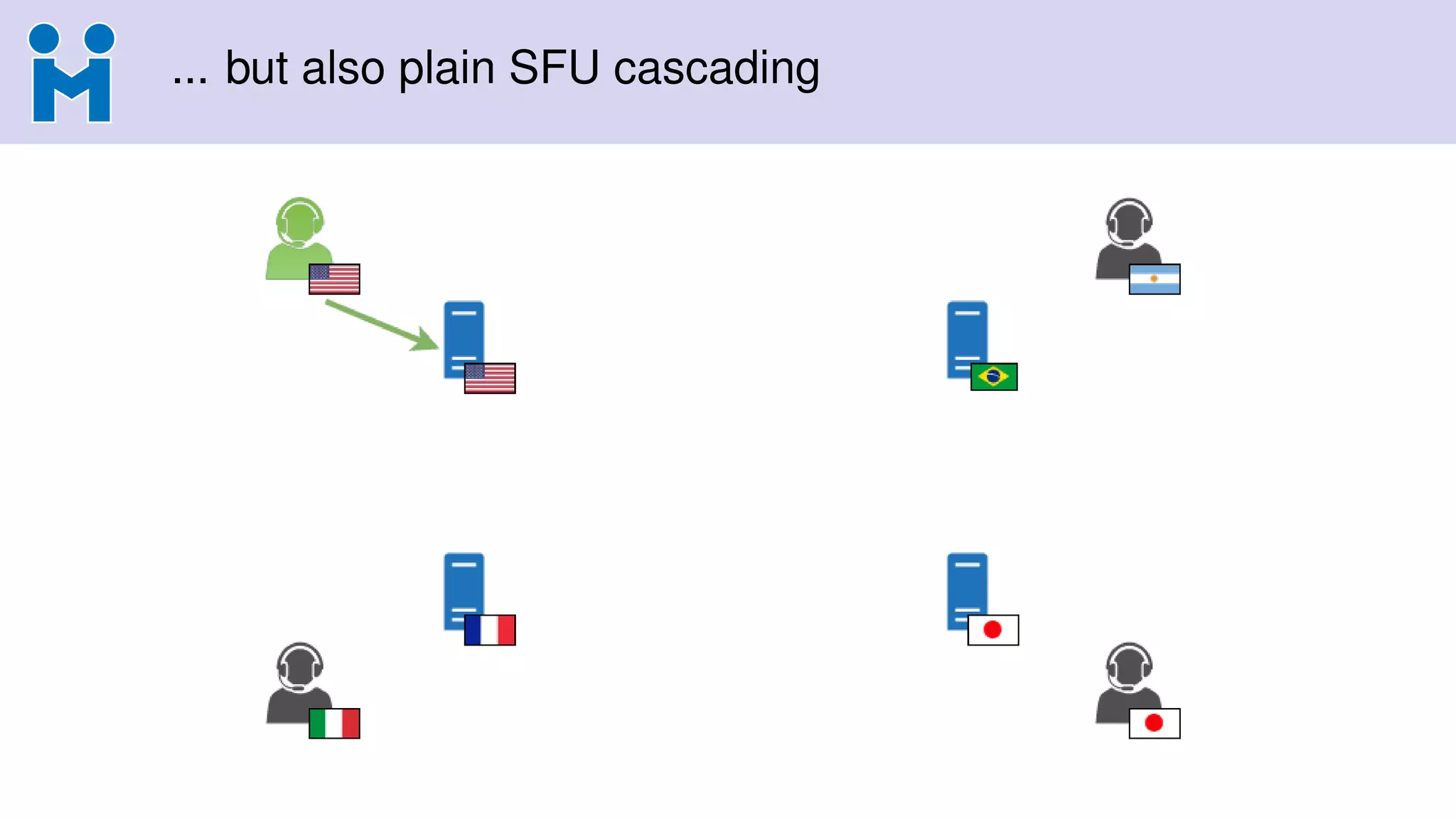

... but also plain SFU cascading
... but also plain SFU cascading

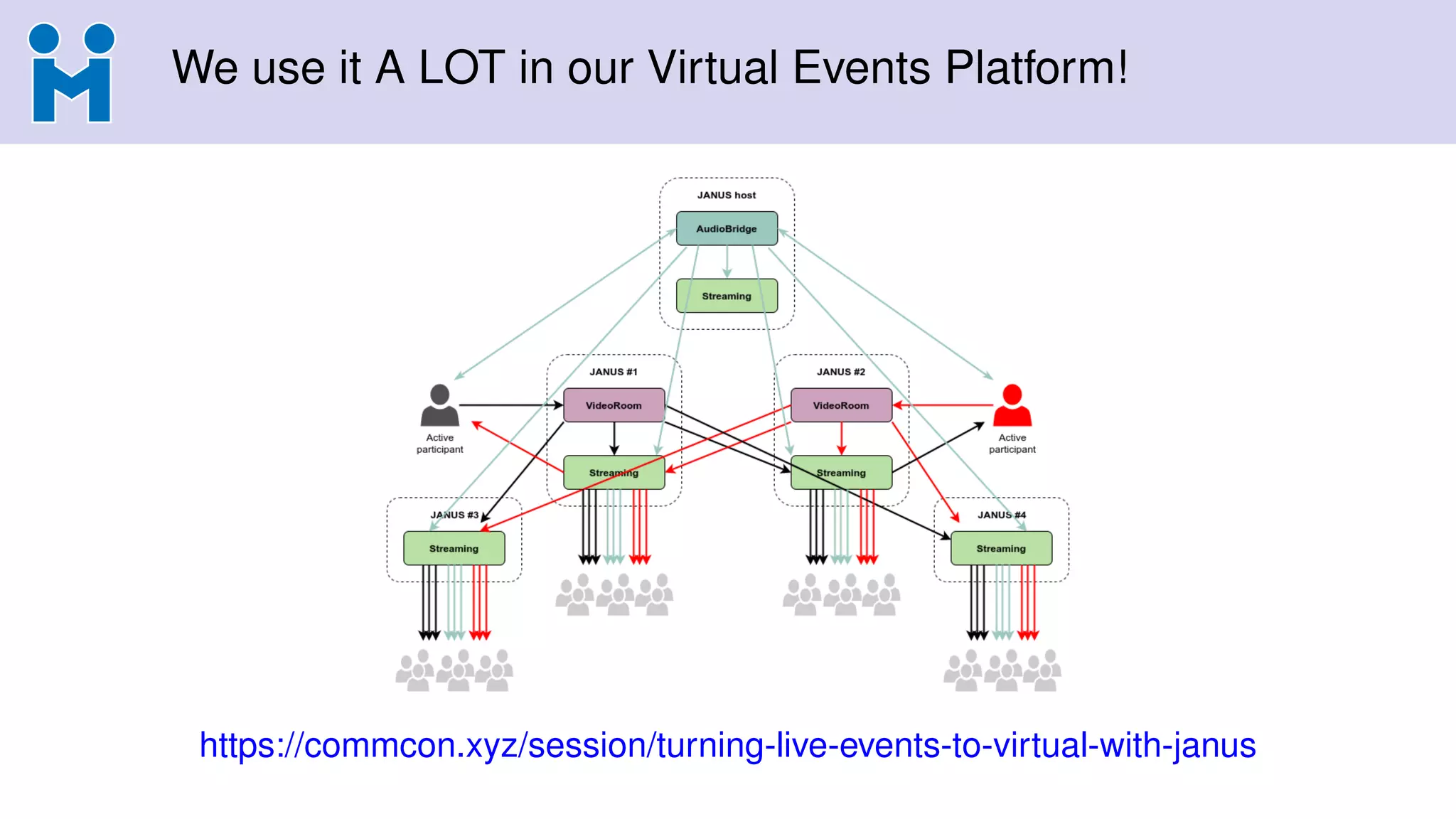

We use it A LOT in our Virtual Events Platform!
https://commcon.xyz/session/turning-live-events-to-virtual-with-janus

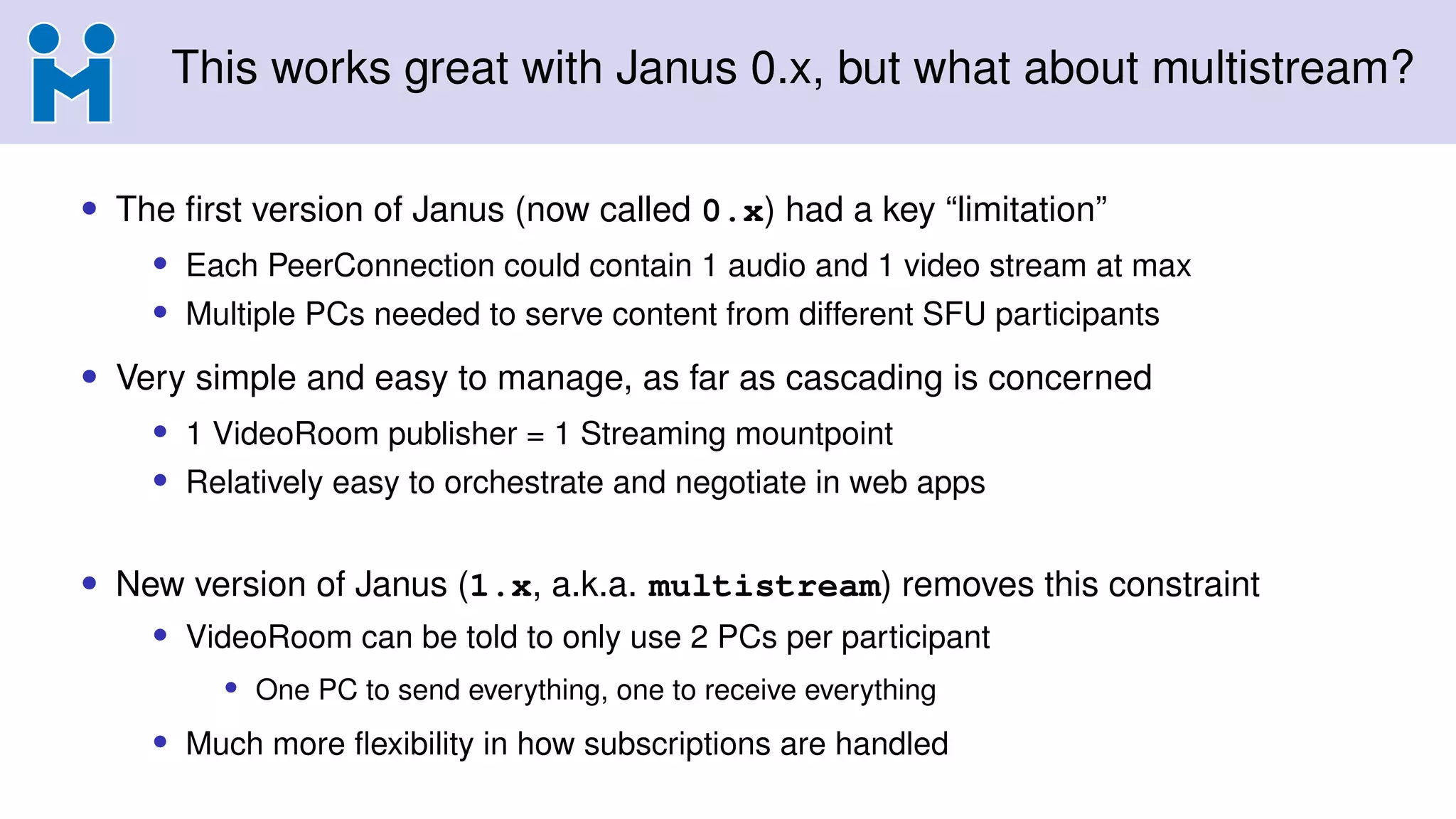

This works great with Janus 0.x, but what about multistream?
• The first version of Janus (now called 0.x) had a key “limitation”
• Each PeerConnection could contain 1 audio and 1 video stream at max
• Multiple PCs needed to serve content from different SFU participants
• Very simple and easy to manage, as far as cascading is concerned
• 1 VideoRoom publisher = 1 Streaming mountpoint
• Relatively easy to orchestrate and negotiate in web apps
• New version of Janus (1.x, a.k.a. multistream) removes this constraint
• VideoRoom can be told to only use 2 PCs per participant
• One PC to send everything, one to receive everything
• Much more flexibility in how subscriptions are handled

This works great with Janus 0.x, but what about multistream?
• The first version of Janus (now called 0.x) had a key “limitation”
• Each PeerConnection could contain 1 audio and 1 video stream at max
• Multiple PCs needed to serve content from different SFU participants
• Very simple and easy to manage, as far as cascading is concerned
• 1 VideoRoom publisher = 1 Streaming mountpoint
• Relatively easy to orchestrate and negotiate in web apps
• New version of Janus (1.x, a.k.a. multistream) removes this constraint
• VideoRoom can be told to only use 2 PCs per participant
• One PC to send everything, one to receive everything
• Much more flexibility in how subscriptions are handled
This works great with Janus 0.x, but what about multistream?
• The first version of Janus (now called 0.x) had a key “limitation”
• Each PeerConnection could contain 1 audio and 1 video stream at max
• Multiple PCs needed to serve content from different SFU participants
• Very simple and easy to manage, as far as cascading is concerned
• 1 VideoRoom publisher = 1 Streaming mountpoint
• Relatively easy to orchestrate and negotiate in web apps
• New version of Janus (1.x, a.k.a. multistream) removes this constraint
• VideoRoom can be told to only use 2 PCs per participant
• One PC to send everything, one to receive everything
• Much more flexibility in how subscriptions are handled

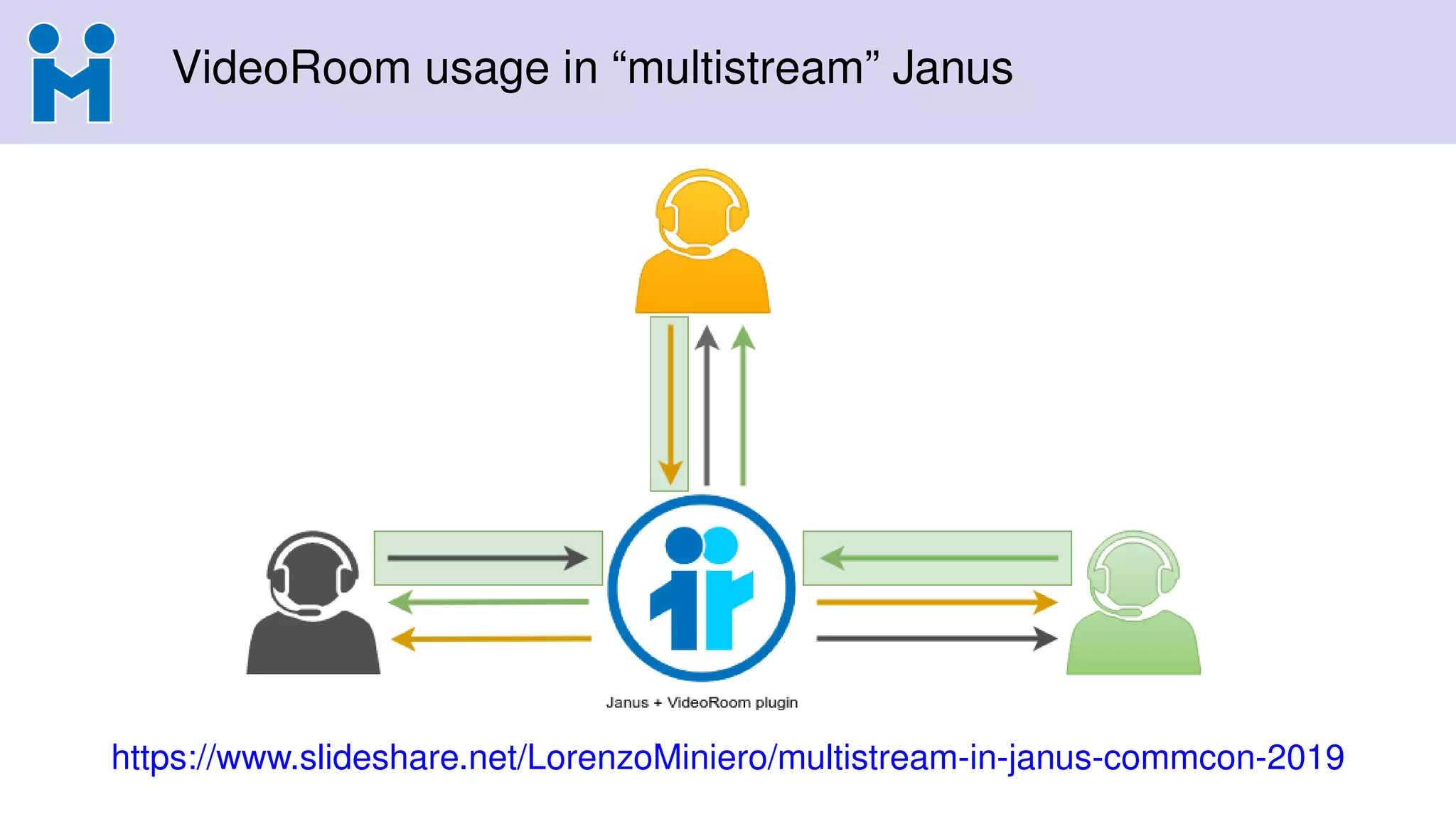

VideoRoom usage in “multistream” Janus
https://www.slideshare.net/LorenzoMiniero/multistream-in-janus-commcon-2019
VideoRoom usage in “multistream” Janus
https://www.slideshare.net/LorenzoMiniero/multistream-in-janus-commcon-2019

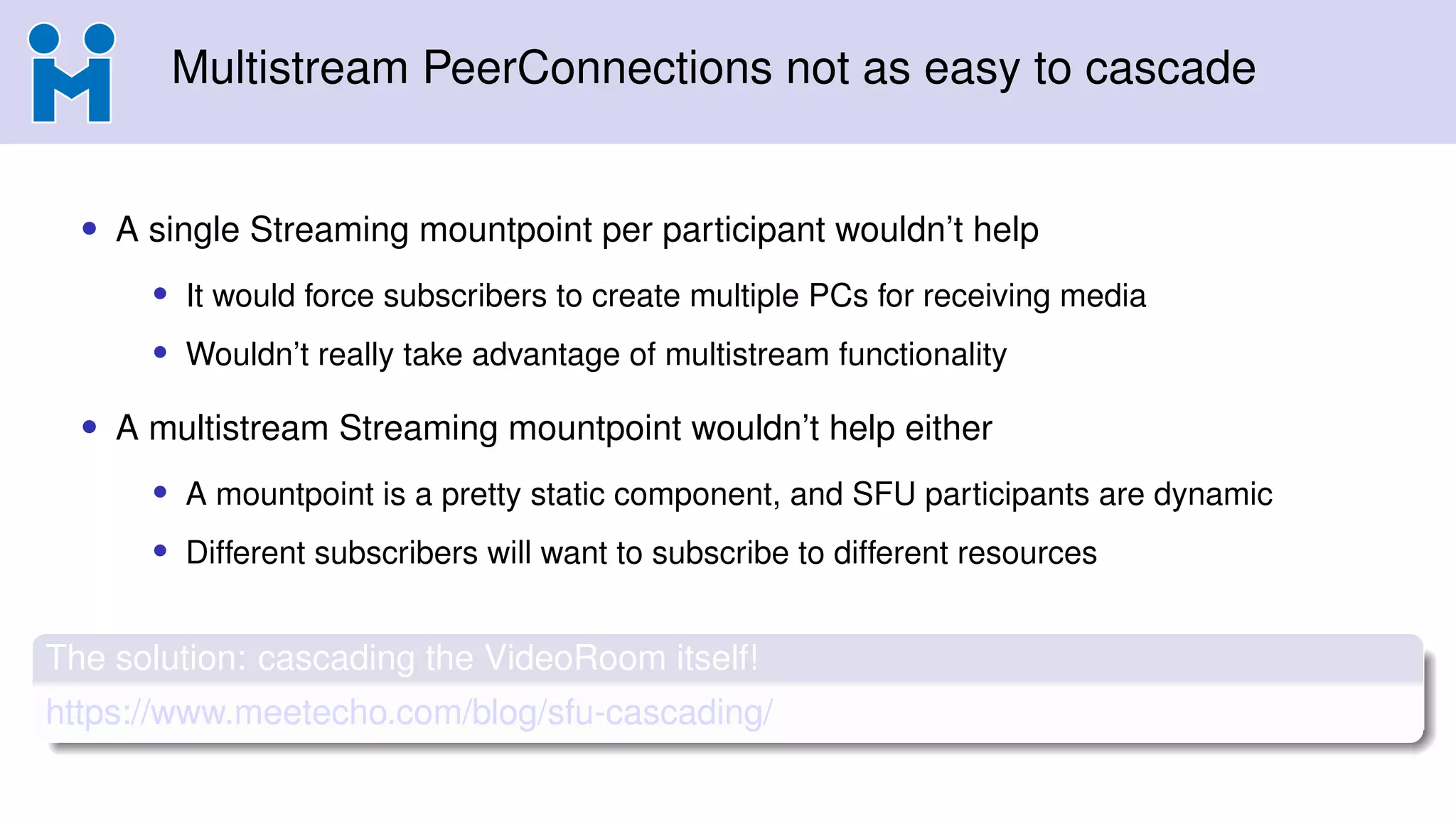

Multistream PeerConnections not as easy to cascade
• A single Streaming mountpoint per participant wouldn’t help
• It would force subscribers to create multiple PCs for receiving media
• Wouldn’t really take advantage of multistream functionality
• A multistream Streaming mountpoint wouldn’t help either
• A mountpoint is a pretty static component, and SFU participants are dynamic
• Different subscribers will want to subscribe to different resources
The solution: cascading the VideoRoom itself!
https://www.meetecho.com/blog/sfu-cascading/

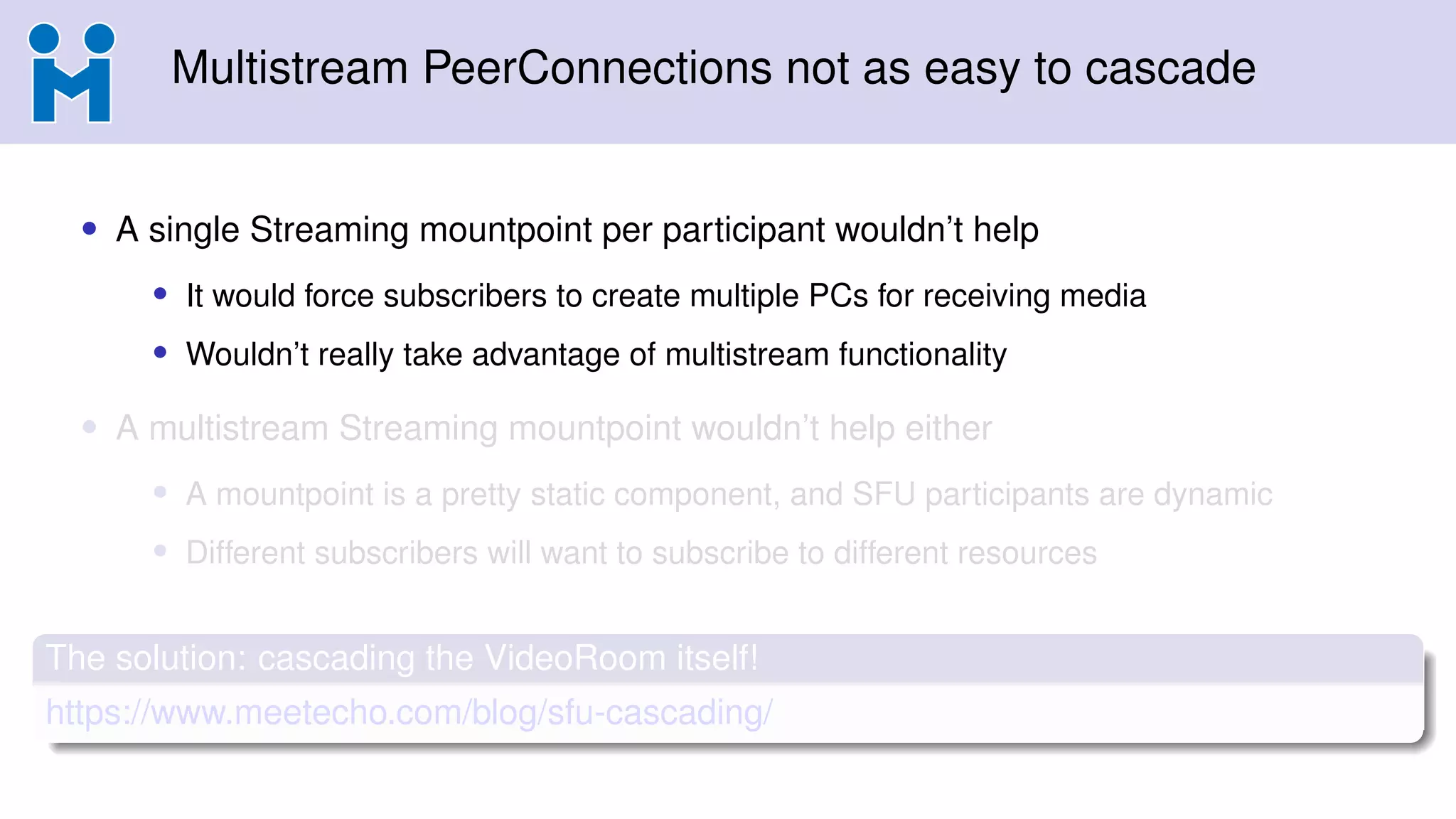

Multistream PeerConnections not as easy to cascade
• A single Streaming mountpoint per participant wouldn’t help
• It would force subscribers to create multiple PCs for receiving media
• Wouldn’t really take advantage of multistream functionality
• A multistream Streaming mountpoint wouldn’t help either
• A mountpoint is a pretty static component, and SFU participants are dynamic
• Different subscribers will want to subscribe to different resources
The solution: cascading the VideoRoom itself!
https://www.meetecho.com/blog/sfu-cascading/

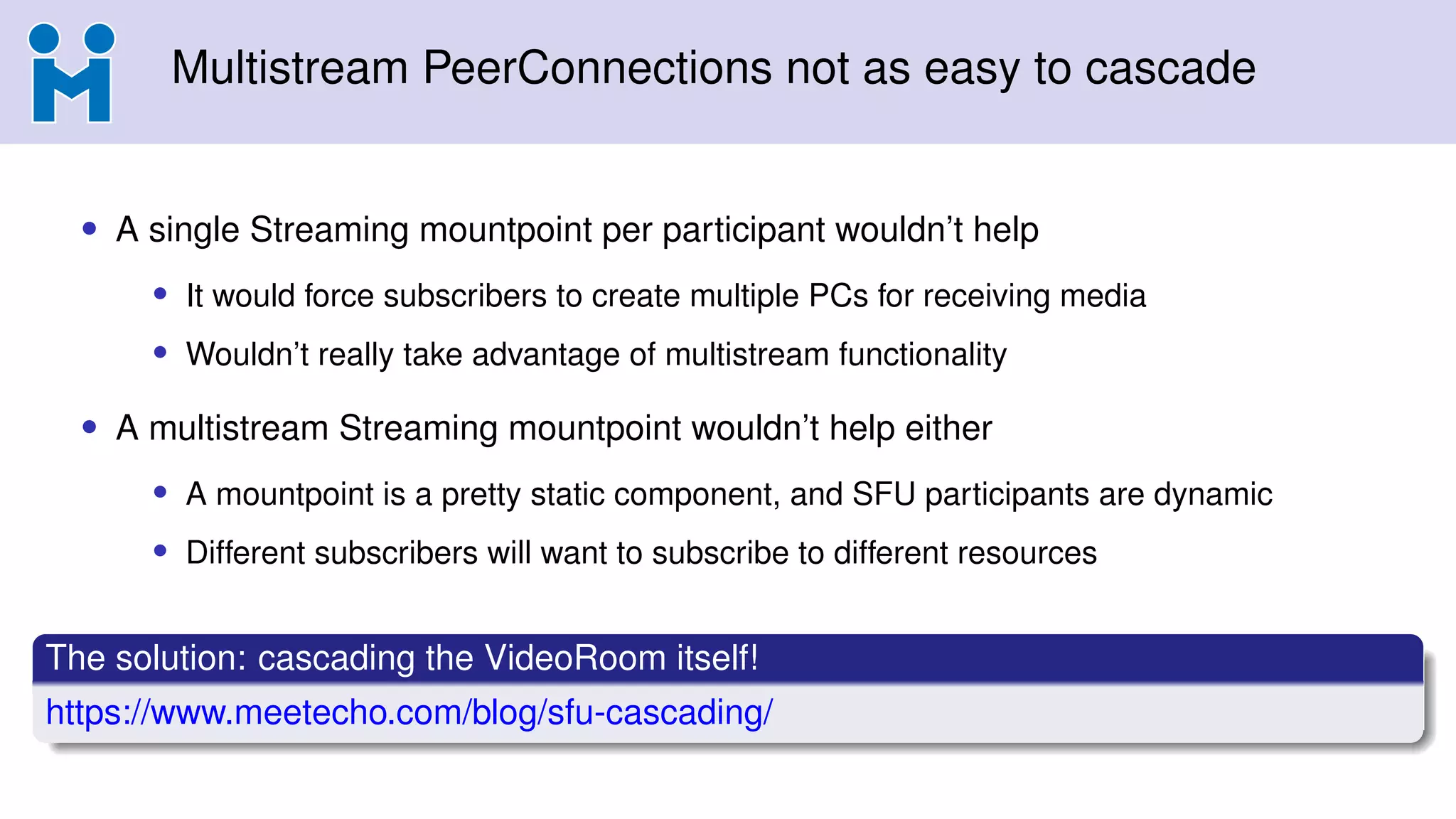

Multistream PeerConnections not as easy to cascade
• A single Streaming mountpoint per participant wouldn’t help
• It would force subscribers to create multiple PCs for receiving media
• Wouldn’t really take advantage of multistream functionality
• A multistream Streaming mountpoint wouldn’t help either
• A mountpoint is a pretty static component, and SFU participants are dynamic
• Different subscribers will want to subscribe to different resources
The solution: cascading the VideoRoom itself!
https://www.meetecho.com/blog/sfu-cascading/

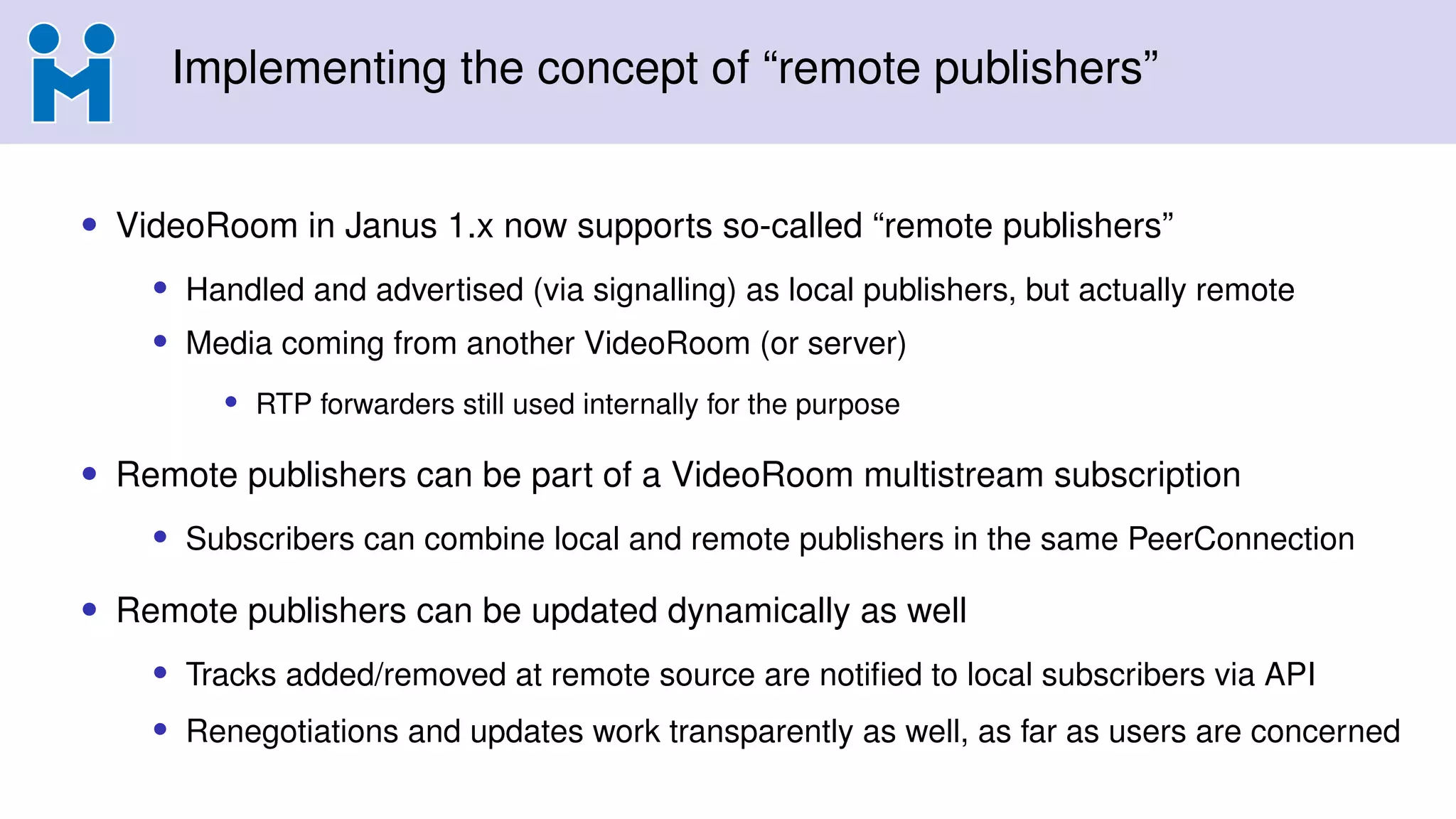

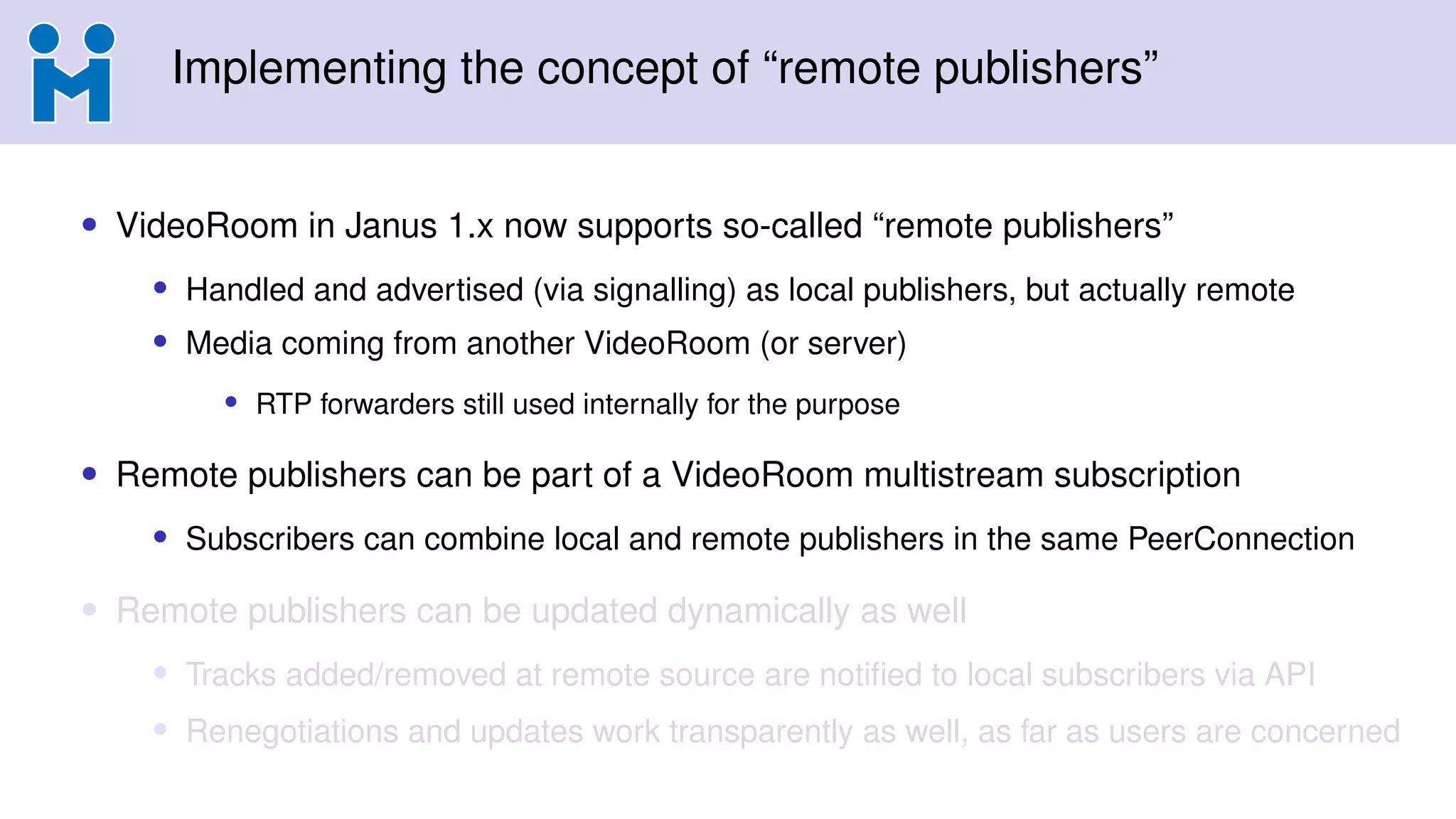

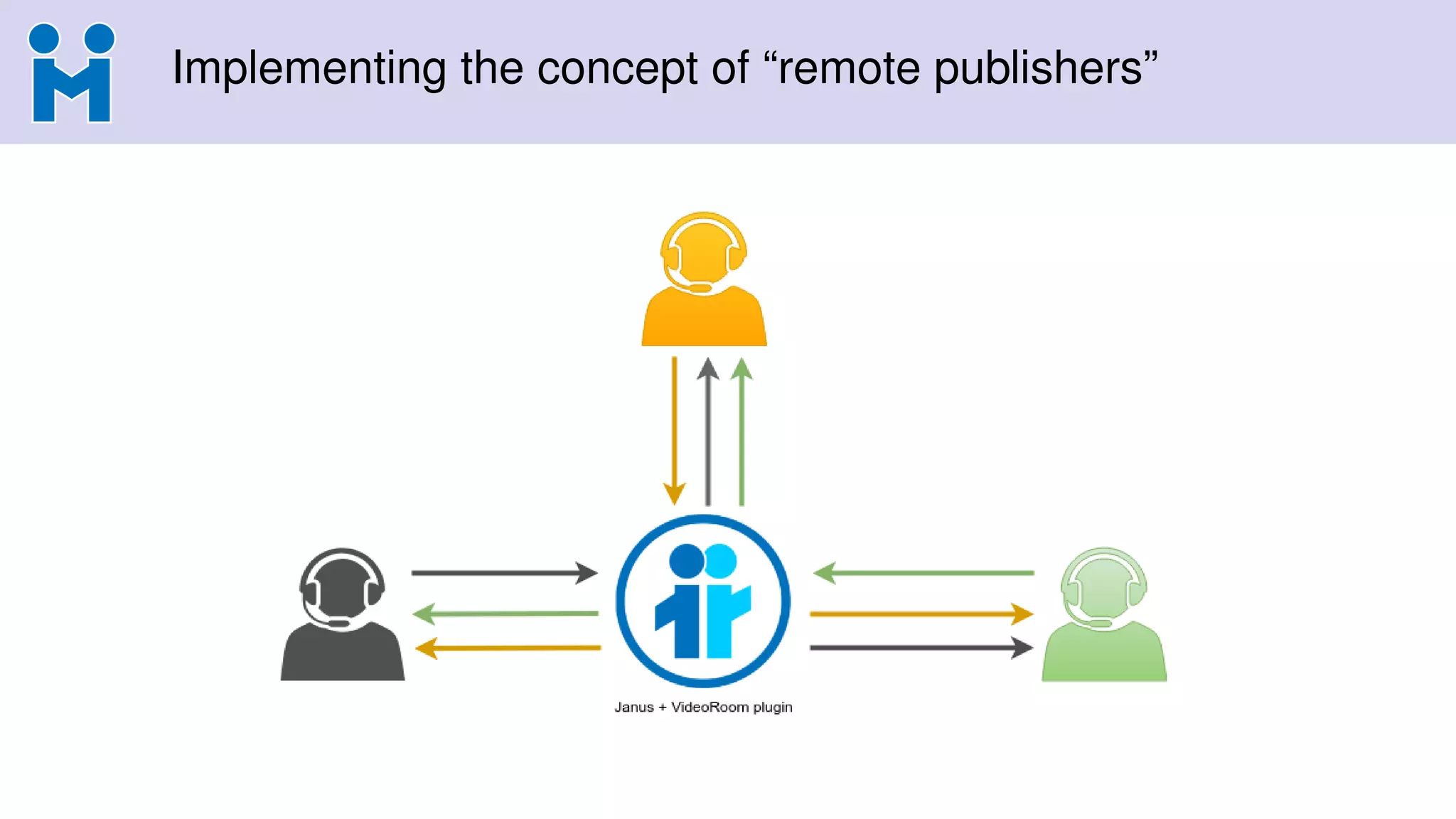

Implementing the concept of “remote publishers”
• VideoRoom in Janus 1.x now supports so-called “remote publishers”
• Handled and advertised (via signalling) as local publishers, but actually remote
• Media coming from another VideoRoom (or server)
• RTP forwarders still used internally for the purpose
• Remote publishers can be part of a VideoRoom multistream subscription
• Subscribers can combine local and remote publishers in the same PeerConnection
• Remote publishers can be updated dynamically as well
• Tracks added/removed at remote source are notified to local subscribers via API
• Renegotiations and updates work transparently as well, as far as users are concerned
Implementing the concept of “remote publishers”
• VideoRoom in Janus 1.x now supports so-called “remote publishers”
• Handled and advertised (via signalling) as local publishers, but actually remote
• Media coming from another VideoRoom (or server)
• RTP forwarders still used internally for the purpose
• Remote publishers can be part of a VideoRoom multistream subscription
• Subscribers can combine local and remote publishers in the same PeerConnection
• Remote publishers can be updated dynamically as well
• Tracks added/removed at remote source are notified to local subscribers via API
• Renegotiations and updates work transparently as well, as far as users are concerned

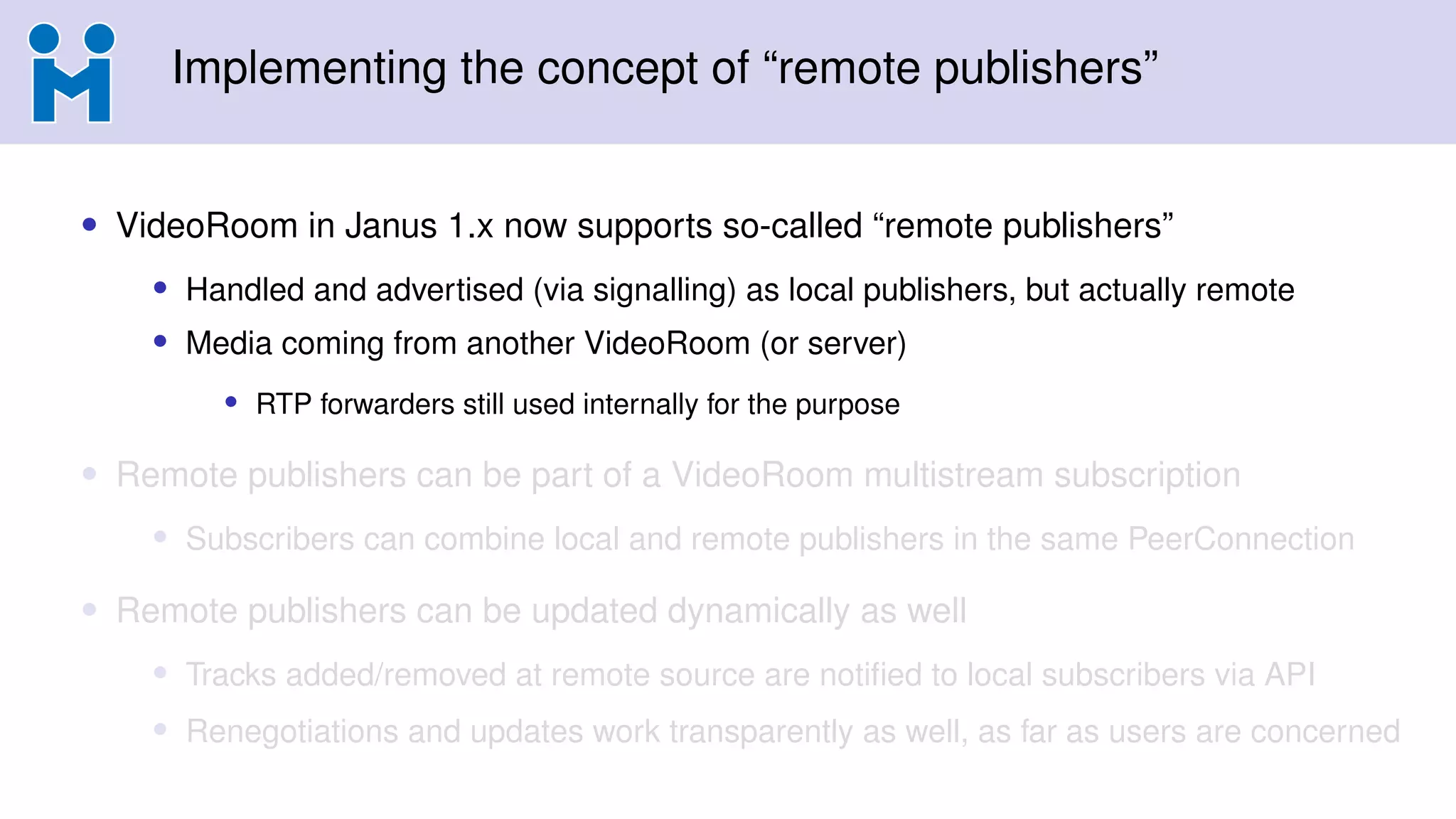

Implementing the concept of “remote publishers”
• VideoRoom in Janus 1.x now supports so-called “remote publishers”
• Handled and advertised (via signalling) as local publishers, but actually remote
• Media coming from another VideoRoom (or server)
• RTP forwarders still used internally for the purpose
• Remote publishers can be part of a VideoRoom multistream subscription
• Subscribers can combine local and remote publishers in the same PeerConnection
• Remote publishers can be updated dynamically as well
• Tracks added/removed at remote source are notified to local subscribers via API
• Renegotiations and updates work transparently as well, as far as users are concerned

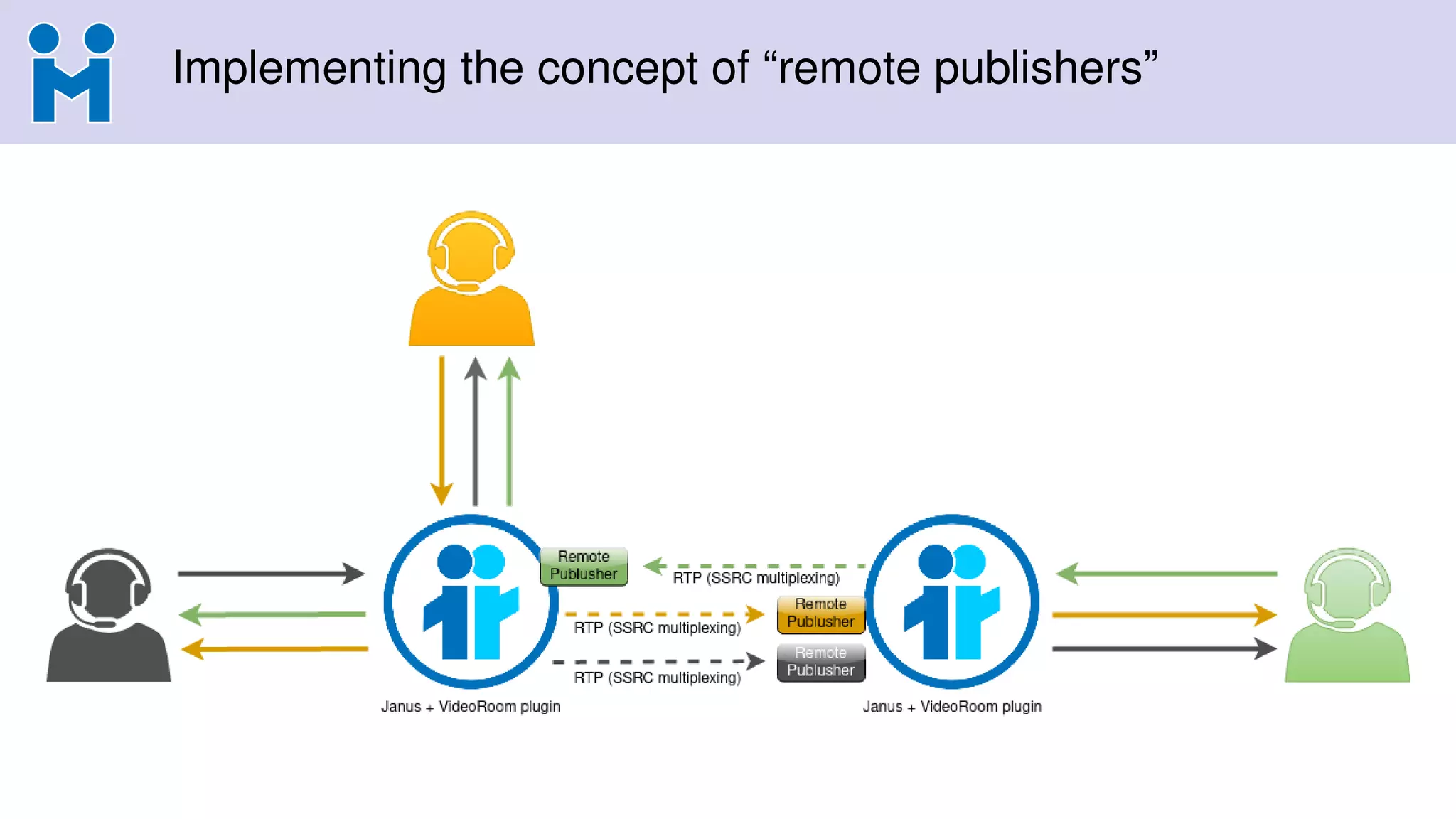

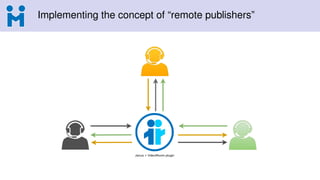

Implementing the concept of “remote publishers”
Implementing the concept of “remote publishers”

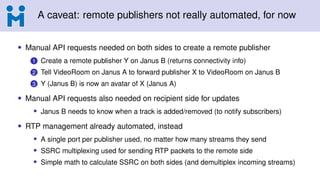

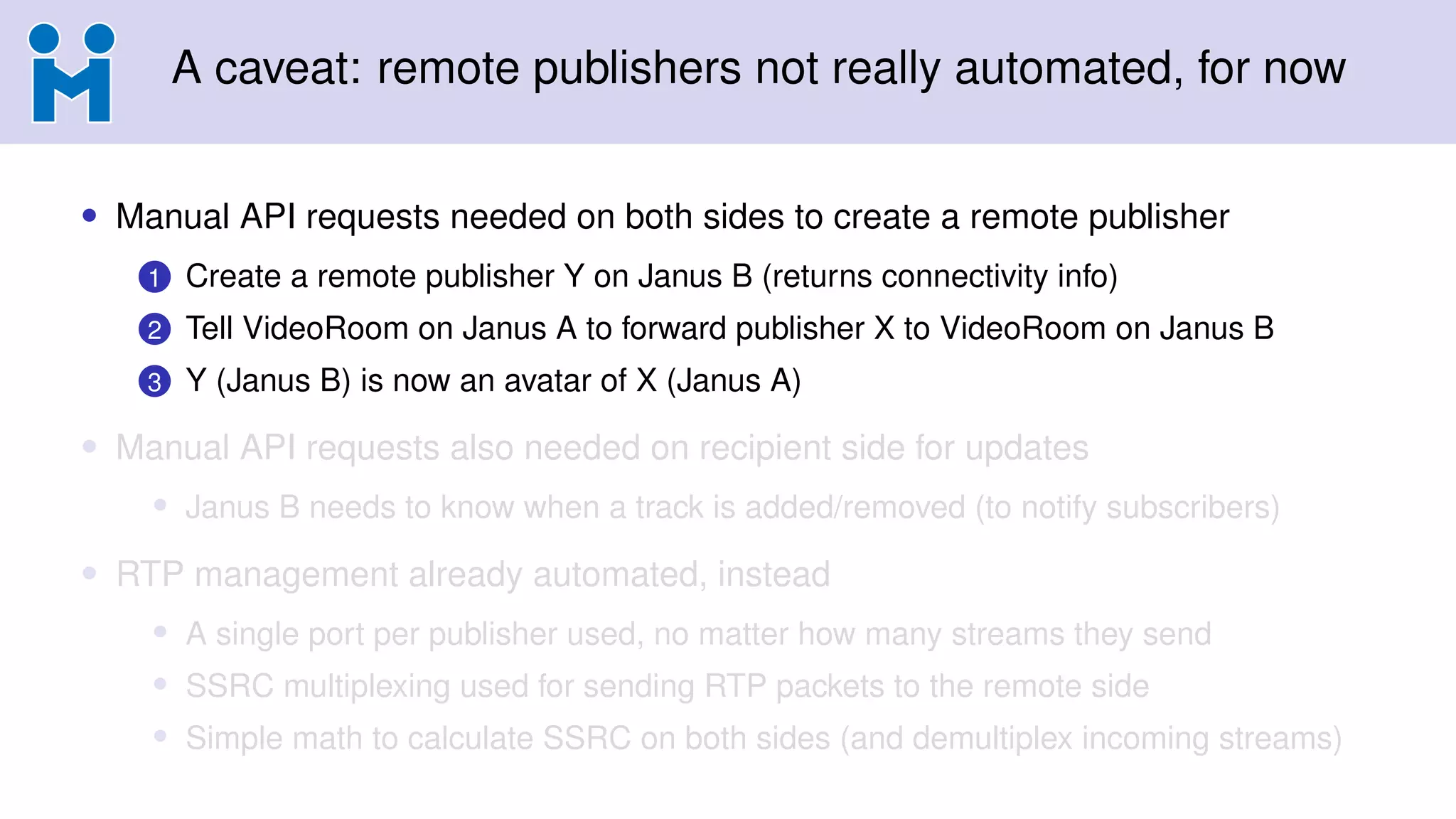

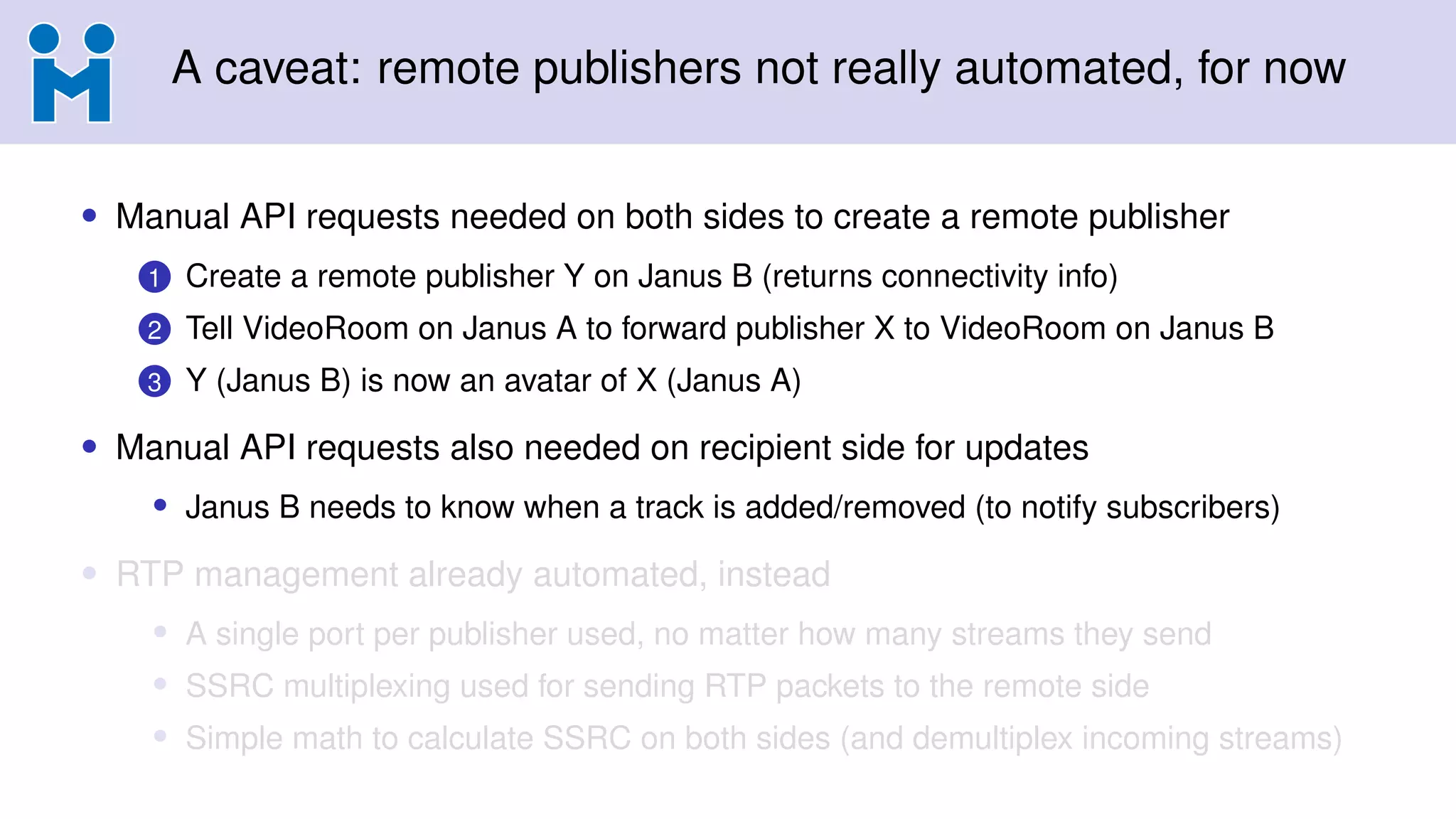

A caveat: remote publishers not really automated, for now
• Manual API requests needed on both sides to create a remote publisher
1 Create a remote publisher Y on Janus B (returns connectivity info)
2 Tell VideoRoom on Janus A to forward publisher X to VideoRoom on Janus B
3 Y (Janus B) is now an avatar of X (Janus A)
• Manual API requests also needed on recipient side for updates
• Janus B needs to know when a track is added/removed (to notify subscribers)
• RTP management already automated, instead
• A single port per publisher used, no matter how many streams they send
• SSRC multiplexing used for sending RTP packets to the remote side
• Simple math to calculate SSRC on both sides (and demultiplex incoming streams)

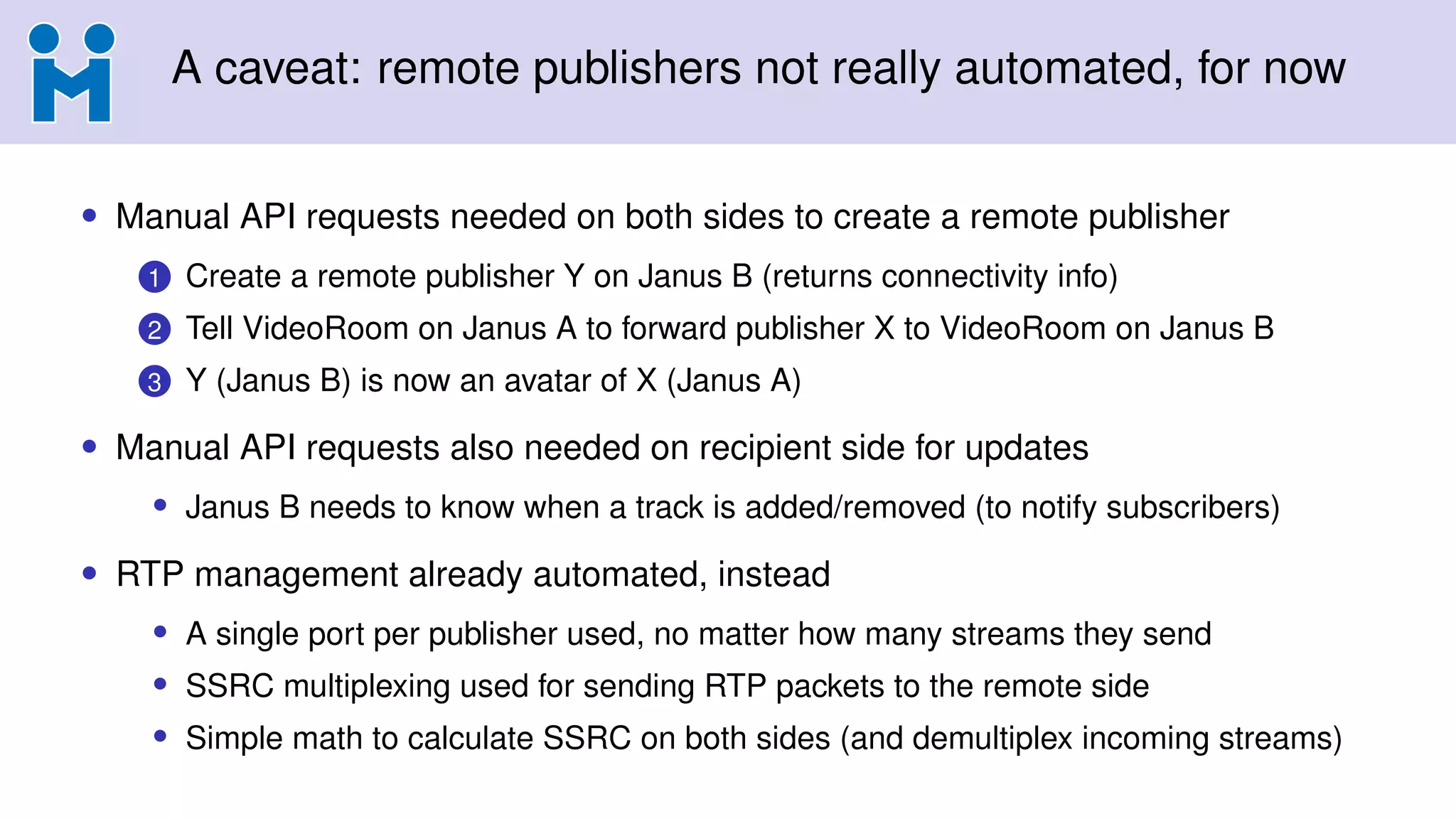

A caveat: remote publishers not really automated, for now
• Manual API requests needed on both sides to create a remote publisher
1 Create a remote publisher Y on Janus B (returns connectivity info)
2 Tell VideoRoom on Janus A to forward publisher X to VideoRoom on Janus B
3 Y (Janus B) is now an avatar of X (Janus A)
• Manual API requests also needed on recipient side for updates
• Janus B needs to know when a track is added/removed (to notify subscribers)
• RTP management already automated, instead
• A single port per publisher used, no matter how many streams they send
• SSRC multiplexing used for sending RTP packets to the remote side
• Simple math to calculate SSRC on both sides (and demultiplex incoming streams)
A caveat: remote publishers not really automated, for now
• Manual API requests needed on both sides to create a remote publisher
1 Create a remote publisher Y on Janus B (returns connectivity info)
2 Tell VideoRoom on Janus A to forward publisher X to VideoRoom on Janus B
3 Y (Janus B) is now an avatar of X (Janus A)
• Manual API requests also needed on recipient side for updates
• Janus B needs to know when a track is added/removed (to notify subscribers)
• RTP management already automated, instead
• A single port per publisher used, no matter how many streams they send
• SSRC multiplexing used for sending RTP packets to the remote side
• Simple math to calculate SSRC on both sides (and demultiplex incoming streams)

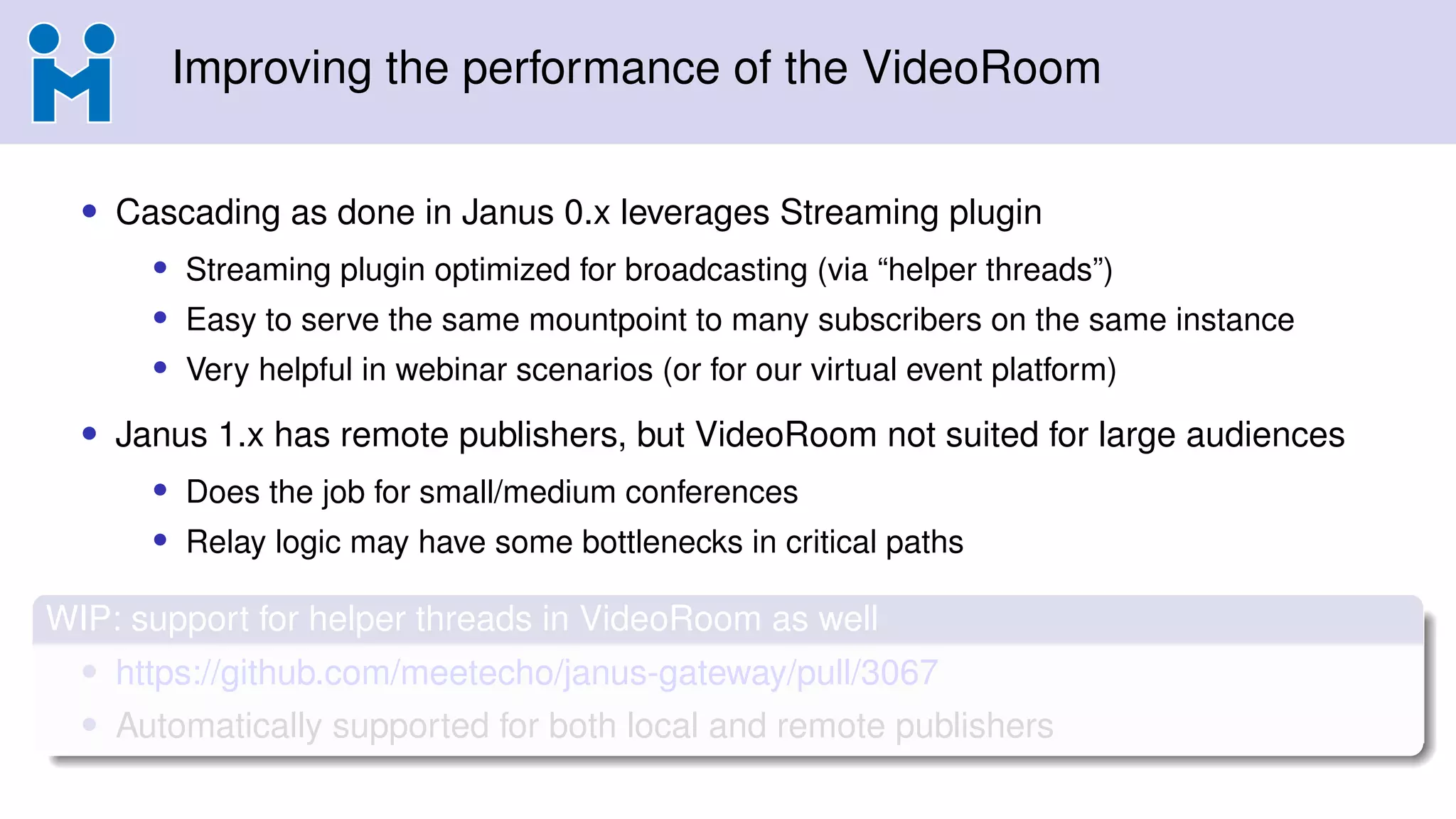

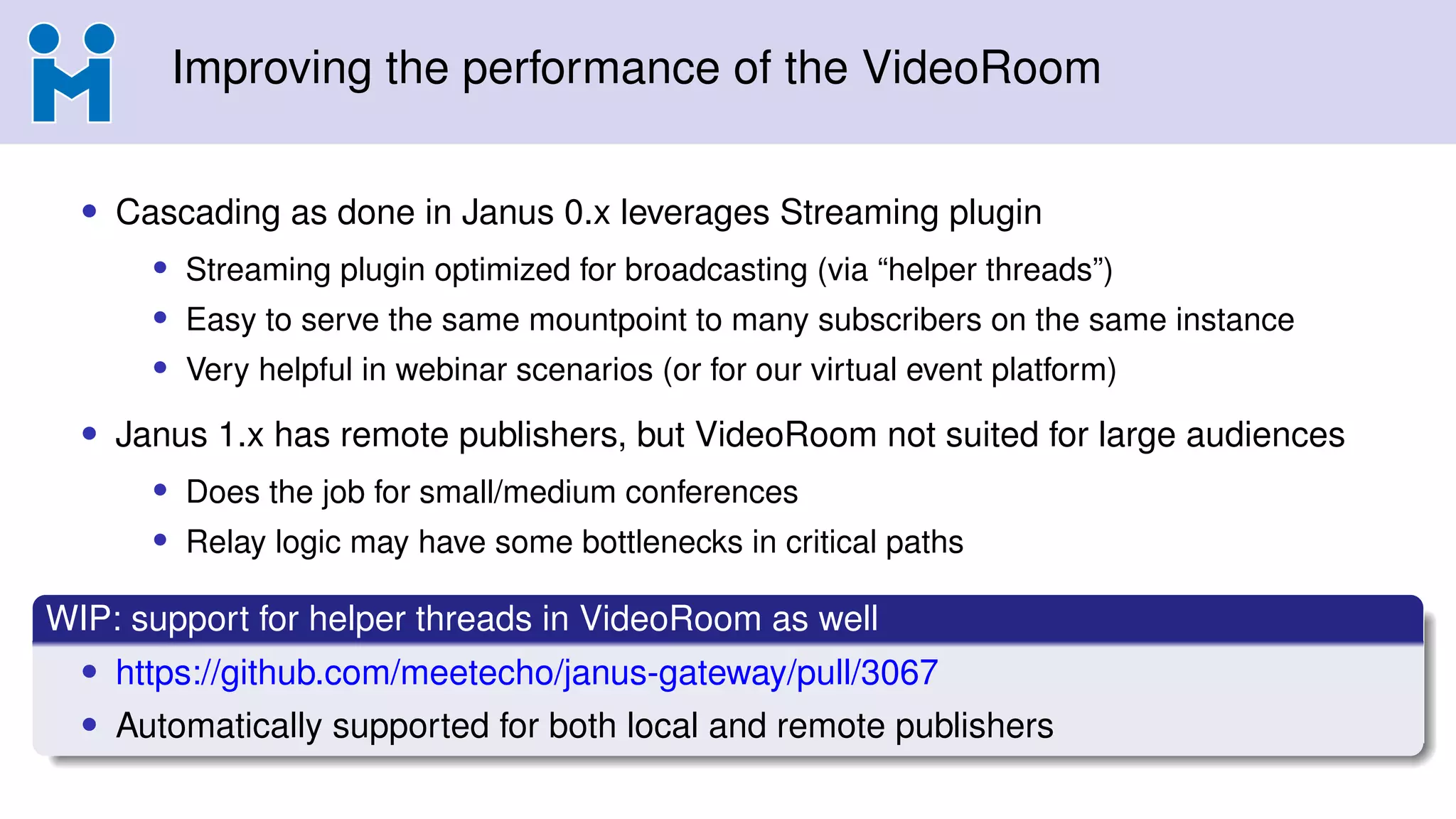

Improving the performance of the VideoRoom
• Cascading as done in Janus 0.x leverages Streaming plugin
• Streaming plugin optimized for broadcasting (via “helper threads”)
• Easy to serve the same mountpoint to many subscribers on the same instance
• Very helpful in webinar scenarios (or for our virtual event platform)
• Janus 1.x has remote publishers, but VideoRoom not suited for large audiences
• Does the job for small/medium conferences
• Relay logic may have some bottlenecks in critical paths
WIP: support for helper threads in VideoRoom as well
• https://github.com/meetecho/janus-gateway/pull/3067
• Automatically supported for both local and remote publishers

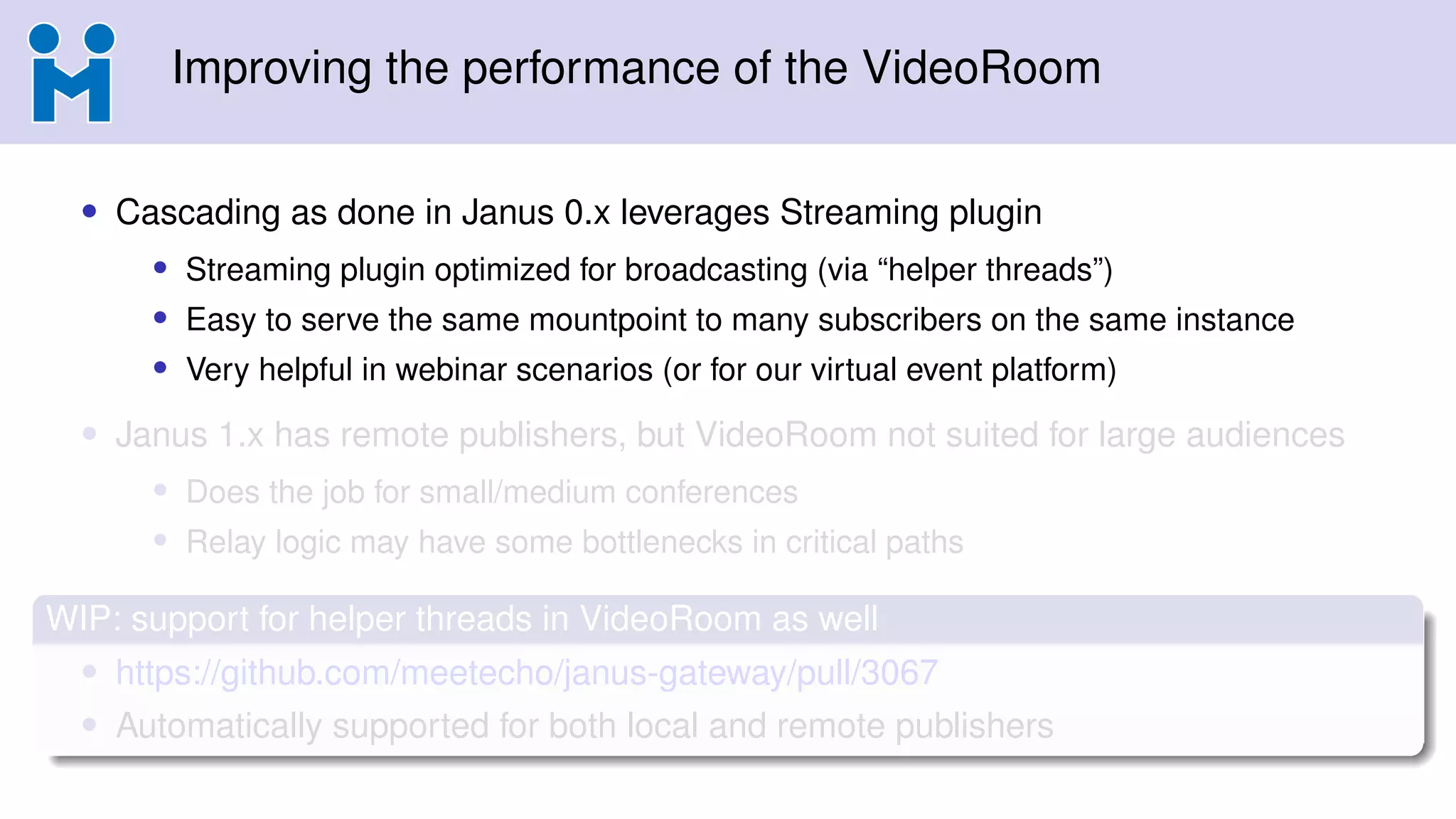

Improving the performance of the VideoRoom
• Cascading as done in Janus 0.x leverages Streaming plugin
• Streaming plugin optimized for broadcasting (via “helper threads”)
• Easy to serve the same mountpoint to many subscribers on the same instance
• Very helpful in webinar scenarios (or for our virtual event platform)
• Janus 1.x has remote publishers, but VideoRoom not suited for large audiences
• Does the job for small/medium conferences
• Relay logic may have some bottlenecks in critical paths
WIP: support for helper threads in VideoRoom as well
• https://github.com/meetecho/janus-gateway/pull/3067
• Automatically supported for both local and remote publishers
Improving the performance of the VideoRoom
• Cascading as done in Janus 0.x leverages Streaming plugin
• Streaming plugin optimized for broadcasting (via “helper threads”)
• Easy to serve the same mountpoint to many subscribers on the same instance
• Very helpful in webinar scenarios (or for our virtual event platform)
• Janus 1.x has remote publishers, but VideoRoom not suited for large audiences
• Does the job for small/medium conferences
• Relay logic may have some bottlenecks in critical paths
WIP: support for helper threads in VideoRoom as well
• https://github.com/meetecho/janus-gateway/pull/3067
• Automatically supported for both local and remote publishers
Thanks! Questions? Comments?
Get in touch!
• https://twitter.com/elminiero
• https://twitter.com/meetecho
• https://www.meetecho.com

Janus SFU cascading @ IIT-RTC 2022

  • 1.
    SFU Cascading withJanus Lorenzo Miniero @elminiero IIT Real-Time Communication 2022 – WebRTC Track October 11th 2022, Chicago, IL, USA
  • 2.
    A few wordsabout me Lorenzo Miniero • Ph.D @ UniNA • Chairman @ Meetecho • Main author of Janus® Contacts and info • lorenzo@meetecho.com • https://twitter.com/elminiero • https://www.slideshare.net/LorenzoMiniero • https://lminiero.bandcamp.com
  • 3.
    A quick reminderon what Janus is! Janus General purpose, open source WebRTC server • https://github.com/meetecho/janus-gateway • Demos and documentation: https://janus.conf.meetecho.com • Community: https://groups.google.com/forum/#!forum/meetecho-janus
  • 4.
    SFU functionality providedby the VideoRoom plugin https://janus.conf.meetecho.com/docs/videoroom
  • 5.
    Historically, different waysto scale Janus (and VideoRoom) https://www.slideshare.net/LorenzoMiniero/scaling-webrtc-applications-with-janus
  • 6.
    RTP forwarders playeda key role https://archive.fosdem.org/2020/schedule/event/janus/
  • 7.
    RTP forwarders playeda key role https://archive.fosdem.org/2020/schedule/event/janus/
  • 8.
    ... especially whencoupled with the Streaming plugin https://janus.conf.meetecho.com/docs/streaming
  • 9.
    ... especially whencoupled with the Streaming plugin https://janus.conf.meetecho.com/docs/streaming
  • 10.
    ... especially whencoupled with the Streaming plugin https://janus.conf.meetecho.com/docs/streaming
  • 11.
    ... why not,maybe using multicast too! https://www.slideshare.net/LorenzoMiniero/scaling-webrtc-deployments-with-multicast-ietf-110-mboned
  • 12.
    Useful for large-scalebroadcasting (e.g., via WHIP) https://www.slideshare.net/LorenzoMiniero/whip-and-janus-iitrtc-2021
  • 13.
    Useful for large-scalebroadcasting (e.g., via WHIP) https://www.slideshare.net/LorenzoMiniero/whip-and-janus-iitrtc-2021
  • 14.
    ... but alsoplain SFU cascading
  • 15.
    ... but alsoplain SFU cascading
  • 16.
    We use itA LOT in our Virtual Events Platform! https://commcon.xyz/session/turning-live-events-to-virtual-with-janus
  • 17.
    This works greatwith Janus 0.x, but what about multistream? • The first version of Janus (now called 0.x) had a key “limitation” • Each PeerConnection could contain 1 audio and 1 video stream at max • Multiple PCs needed to serve content from different SFU participants • Very simple and easy to manage, as far as cascading is concerned • 1 VideoRoom publisher = 1 Streaming mountpoint • Relatively easy to orchestrate and negotiate in web apps • New version of Janus (1.x, a.k.a. multistream) removes this constraint • VideoRoom can be told to only use 2 PCs per participant • One PC to send everything, one to receive everything • Much more flexibility in how subscriptions are handled
  • 18.
    This works greatwith Janus 0.x, but what about multistream? • The first version of Janus (now called 0.x) had a key “limitation” • Each PeerConnection could contain 1 audio and 1 video stream at max • Multiple PCs needed to serve content from different SFU participants • Very simple and easy to manage, as far as cascading is concerned • 1 VideoRoom publisher = 1 Streaming mountpoint • Relatively easy to orchestrate and negotiate in web apps • New version of Janus (1.x, a.k.a. multistream) removes this constraint • VideoRoom can be told to only use 2 PCs per participant • One PC to send everything, one to receive everything • Much more flexibility in how subscriptions are handled
  • 19.
    This works greatwith Janus 0.x, but what about multistream? • The first version of Janus (now called 0.x) had a key “limitation” • Each PeerConnection could contain 1 audio and 1 video stream at max • Multiple PCs needed to serve content from different SFU participants • Very simple and easy to manage, as far as cascading is concerned • 1 VideoRoom publisher = 1 Streaming mountpoint • Relatively easy to orchestrate and negotiate in web apps • New version of Janus (1.x, a.k.a. multistream) removes this constraint • VideoRoom can be told to only use 2 PCs per participant • One PC to send everything, one to receive everything • Much more flexibility in how subscriptions are handled
  • 20.
    VideoRoom usage in“multistream” Janus https://www.slideshare.net/LorenzoMiniero/multistream-in-janus-commcon-2019
  • 21.
    VideoRoom usage in“multistream” Janus https://www.slideshare.net/LorenzoMiniero/multistream-in-janus-commcon-2019
  • 22.
    Multistream PeerConnections notas easy to cascade • A single Streaming mountpoint per participant wouldn’t help • It would force subscribers to create multiple PCs for receiving media • Wouldn’t really take advantage of multistream functionality • A multistream Streaming mountpoint wouldn’t help either • A mountpoint is a pretty static component, and SFU participants are dynamic • Different subscribers will want to subscribe to different resources The solution: cascading the VideoRoom itself! https://www.meetecho.com/blog/sfu-cascading/
  • 23.
    Multistream PeerConnections notas easy to cascade • A single Streaming mountpoint per participant wouldn’t help • It would force subscribers to create multiple PCs for receiving media • Wouldn’t really take advantage of multistream functionality • A multistream Streaming mountpoint wouldn’t help either • A mountpoint is a pretty static component, and SFU participants are dynamic • Different subscribers will want to subscribe to different resources The solution: cascading the VideoRoom itself! https://www.meetecho.com/blog/sfu-cascading/
  • 24.
    Multistream PeerConnections notas easy to cascade • A single Streaming mountpoint per participant wouldn’t help • It would force subscribers to create multiple PCs for receiving media • Wouldn’t really take advantage of multistream functionality • A multistream Streaming mountpoint wouldn’t help either • A mountpoint is a pretty static component, and SFU participants are dynamic • Different subscribers will want to subscribe to different resources The solution: cascading the VideoRoom itself! https://www.meetecho.com/blog/sfu-cascading/
  • 25.
    Implementing the conceptof “remote publishers” • VideoRoom in Janus 1.x now supports so-called “remote publishers” • Handled and advertised (via signalling) as local publishers, but actually remote • Media coming from another VideoRoom (or server) • RTP forwarders still used internally for the purpose • Remote publishers can be part of a VideoRoom multistream subscription • Subscribers can combine local and remote publishers in the same PeerConnection • Remote publishers can be updated dynamically as well • Tracks added/removed at remote source are notified to local subscribers via API • Renegotiations and updates work transparently as well, as far as users are concerned
  • 26.
    Implementing the conceptof “remote publishers” • VideoRoom in Janus 1.x now supports so-called “remote publishers” • Handled and advertised (via signalling) as local publishers, but actually remote • Media coming from another VideoRoom (or server) • RTP forwarders still used internally for the purpose • Remote publishers can be part of a VideoRoom multistream subscription • Subscribers can combine local and remote publishers in the same PeerConnection • Remote publishers can be updated dynamically as well • Tracks added/removed at remote source are notified to local subscribers via API • Renegotiations and updates work transparently as well, as far as users are concerned
  • 27.
    Implementing the conceptof “remote publishers” • VideoRoom in Janus 1.x now supports so-called “remote publishers” • Handled and advertised (via signalling) as local publishers, but actually remote • Media coming from another VideoRoom (or server) • RTP forwarders still used internally for the purpose • Remote publishers can be part of a VideoRoom multistream subscription • Subscribers can combine local and remote publishers in the same PeerConnection • Remote publishers can be updated dynamically as well • Tracks added/removed at remote source are notified to local subscribers via API • Renegotiations and updates work transparently as well, as far as users are concerned
  • 28.
    Implementing the conceptof “remote publishers”
  • 29.
    Implementing the conceptof “remote publishers”
  • 30.
    A caveat: remotepublishers not really automated, for now • Manual API requests needed on both sides to create a remote publisher 1 Create a remote publisher Y on Janus B (returns connectivity info) 2 Tell VideoRoom on Janus A to forward publisher X to VideoRoom on Janus B 3 Y (Janus B) is now an avatar of X (Janus A) • Manual API requests also needed on recipient side for updates • Janus B needs to know when a track is added/removed (to notify subscribers) • RTP management already automated, instead • A single port per publisher used, no matter how many streams they send • SSRC multiplexing used for sending RTP packets to the remote side • Simple math to calculate SSRC on both sides (and demultiplex incoming streams)
  • 31.
    A caveat: remotepublishers not really automated, for now • Manual API requests needed on both sides to create a remote publisher 1 Create a remote publisher Y on Janus B (returns connectivity info) 2 Tell VideoRoom on Janus A to forward publisher X to VideoRoom on Janus B 3 Y (Janus B) is now an avatar of X (Janus A) • Manual API requests also needed on recipient side for updates • Janus B needs to know when a track is added/removed (to notify subscribers) • RTP management already automated, instead • A single port per publisher used, no matter how many streams they send • SSRC multiplexing used for sending RTP packets to the remote side • Simple math to calculate SSRC on both sides (and demultiplex incoming streams)
  • 32.
    A caveat: remotepublishers not really automated, for now • Manual API requests needed on both sides to create a remote publisher 1 Create a remote publisher Y on Janus B (returns connectivity info) 2 Tell VideoRoom on Janus A to forward publisher X to VideoRoom on Janus B 3 Y (Janus B) is now an avatar of X (Janus A) • Manual API requests also needed on recipient side for updates • Janus B needs to know when a track is added/removed (to notify subscribers) • RTP management already automated, instead • A single port per publisher used, no matter how many streams they send • SSRC multiplexing used for sending RTP packets to the remote side • Simple math to calculate SSRC on both sides (and demultiplex incoming streams)
  • 33.
    Improving the performanceof the VideoRoom • Cascading as done in Janus 0.x leverages Streaming plugin • Streaming plugin optimized for broadcasting (via “helper threads”) • Easy to serve the same mountpoint to many subscribers on the same instance • Very helpful in webinar scenarios (or for our virtual event platform) • Janus 1.x has remote publishers, but VideoRoom not suited for large audiences • Does the job for small/medium conferences • Relay logic may have some bottlenecks in critical paths WIP: support for helper threads in VideoRoom as well • https://github.com/meetecho/janus-gateway/pull/3067 • Automatically supported for both local and remote publishers
  • 34.
    Improving the performanceof the VideoRoom • Cascading as done in Janus 0.x leverages Streaming plugin • Streaming plugin optimized for broadcasting (via “helper threads”) • Easy to serve the same mountpoint to many subscribers on the same instance • Very helpful in webinar scenarios (or for our virtual event platform) • Janus 1.x has remote publishers, but VideoRoom not suited for large audiences • Does the job for small/medium conferences • Relay logic may have some bottlenecks in critical paths WIP: support for helper threads in VideoRoom as well • https://github.com/meetecho/janus-gateway/pull/3067 • Automatically supported for both local and remote publishers
  • 35.
    Improving the performanceof the VideoRoom • Cascading as done in Janus 0.x leverages Streaming plugin • Streaming plugin optimized for broadcasting (via “helper threads”) • Easy to serve the same mountpoint to many subscribers on the same instance • Very helpful in webinar scenarios (or for our virtual event platform) • Janus 1.x has remote publishers, but VideoRoom not suited for large audiences • Does the job for small/medium conferences • Relay logic may have some bottlenecks in critical paths WIP: support for helper threads in VideoRoom as well • https://github.com/meetecho/janus-gateway/pull/3067 • Automatically supported for both local and remote publishers
  • 36.
    Thanks! Questions? Comments? Getin touch! • https://twitter.com/elminiero • https://twitter.com/meetecho • https://www.meetecho.com
