An ordinance is proposed to amend the city's code of ordinances regarding permitting and contractor registration for building projects. The amendments aim to encourage timely completion of residential construction projects and limit impacts from non-performing contractors. The changes include additional insurance, affidavit, and documentation requirements for permits and registrations. It also allows the city to suspend or revoke permits and registrations for cause, subject to appeal.
- The document discusses proposed amendments to residential construction policies to address issues with projects taking too long or being abandoned.
- The amendments aim to encourage timely completion of residential projects and limit impact of non-performing contractors through additional contractor registration requirements, insurance mandates, and enforcement tools like permit suspensions.
- City staff will present the proposed policy changes to address public nuisances from partially-built residential projects.
- The document discusses potential amendments to address issues with residential construction projects being abandoned or taking too long to complete in the city. It outlines two potential amendments - additional contractor registration requirements and enforcement tools, and adopting regulations for declaring abandoned projects as substandard structures. The amendments aim to encourage timely completion of projects and limit impact of non-performing contractors.
The document is a city council agenda memorandum proposing an ordinance to amend the city's code of ordinances to add regulations for substandard, unsecured, and dangerous buildings. The proposed ordinance would grant the city authority under state law to identify and address buildings posing health and safety risks. It defines substandard buildings and outlines enforcement procedures such as inspections, orders to repair or demolish buildings, and penalties. The intent is to protect public health and safety.
Item # 9 - Freese and Nichols Contract Extensionahcitycouncil
This memorandum requests that the City Council approve renewing the contract with Freese and Nichols, Inc. for another year to provide project management, engineering, and floodplain development permit review services. The contract would extend the existing agreement and add floodplain review services. Freese and Nichols has provided services to the city since 2007 at reasonable costs compared to other cities.
The document provides an overview of spatial development processes at the Metropolitan, Municipal and District Assemblies (MMDAs) and the role of the Works Department. It discusses the establishment and structure of the Works Department, development permitting requirements, responsibilities under the Ghana Building Code, and the relationship between Works and Physical Planning Departments. It emphasizes the importance of strong institutions and legal frameworks for development and economic growth.
Extension of Time (EoT) in Construction Project presentationAyush Joshi
The document discusses extension of time (EOT) in construction projects. It outlines factors that can cause delays and qualify for an EOT, including weather, site conditions, design issues, and delays by owners or other contractors. It also summarizes requirements for applying for and approving EOTs according to standard contract forms and Nepalese law. Contractors must apply before the deadline and prove delays were outside their control. EOT approval depends on the length of extension needed and requires investigation by the owner. Liquidated damages may be assessed for contractor delays, but contracts also provide rewards for early completion.
This document summarizes construction details related to active construction projects in Florida, including construction contracts, major transportation projects, and general construction operations. It provides information on construction equipment requirements, experimental equipment approval processes, mobilization and maintenance of traffic procedures, and erosion control measures to prevent water pollution during construction activities. Temporary work structures, detour operations, and prevention of erosion and water pollution are also addressed at a high level.
This document discusses building regulations and violations in Chennai, India. It provides context on regulations established by the Chennai Metropolitan Development Authority to guide construction and development. However, widespread violations of these regulations have been observed, including excessive ground coverage, floor area ratios, height restrictions, and lack of parking. Factors contributing to violations include unrealistic regulations, supply shortages, and corruption in the permitting process. In response, Chennai has established enforcement teams, considered monitoring architects and surveyors more closely, and discussed sharing sanctioned plans with neighbors to improve compliance. Overall, the document examines the current state of regulations and efforts to curb growing violations in Chennai's construction industry.
- The document discusses proposed amendments to residential construction policies to address issues with projects taking too long or being abandoned.
- The amendments aim to encourage timely completion of residential projects and limit impact of non-performing contractors through additional contractor registration requirements, insurance mandates, and enforcement tools like permit suspensions.
- City staff will present the proposed policy changes to address public nuisances from partially-built residential projects.
- The document discusses potential amendments to address issues with residential construction projects being abandoned or taking too long to complete in the city. It outlines two potential amendments - additional contractor registration requirements and enforcement tools, and adopting regulations for declaring abandoned projects as substandard structures. The amendments aim to encourage timely completion of projects and limit impact of non-performing contractors.
The document is a city council agenda memorandum proposing an ordinance to amend the city's code of ordinances to add regulations for substandard, unsecured, and dangerous buildings. The proposed ordinance would grant the city authority under state law to identify and address buildings posing health and safety risks. It defines substandard buildings and outlines enforcement procedures such as inspections, orders to repair or demolish buildings, and penalties. The intent is to protect public health and safety.
Item # 9 - Freese and Nichols Contract Extensionahcitycouncil
This memorandum requests that the City Council approve renewing the contract with Freese and Nichols, Inc. for another year to provide project management, engineering, and floodplain development permit review services. The contract would extend the existing agreement and add floodplain review services. Freese and Nichols has provided services to the city since 2007 at reasonable costs compared to other cities.
The document provides an overview of spatial development processes at the Metropolitan, Municipal and District Assemblies (MMDAs) and the role of the Works Department. It discusses the establishment and structure of the Works Department, development permitting requirements, responsibilities under the Ghana Building Code, and the relationship between Works and Physical Planning Departments. It emphasizes the importance of strong institutions and legal frameworks for development and economic growth.
Extension of Time (EoT) in Construction Project presentationAyush Joshi
The document discusses extension of time (EOT) in construction projects. It outlines factors that can cause delays and qualify for an EOT, including weather, site conditions, design issues, and delays by owners or other contractors. It also summarizes requirements for applying for and approving EOTs according to standard contract forms and Nepalese law. Contractors must apply before the deadline and prove delays were outside their control. EOT approval depends on the length of extension needed and requires investigation by the owner. Liquidated damages may be assessed for contractor delays, but contracts also provide rewards for early completion.
This document summarizes construction details related to active construction projects in Florida, including construction contracts, major transportation projects, and general construction operations. It provides information on construction equipment requirements, experimental equipment approval processes, mobilization and maintenance of traffic procedures, and erosion control measures to prevent water pollution during construction activities. Temporary work structures, detour operations, and prevention of erosion and water pollution are also addressed at a high level.
This document discusses building regulations and violations in Chennai, India. It provides context on regulations established by the Chennai Metropolitan Development Authority to guide construction and development. However, widespread violations of these regulations have been observed, including excessive ground coverage, floor area ratios, height restrictions, and lack of parking. Factors contributing to violations include unrealistic regulations, supply shortages, and corruption in the permitting process. In response, Chennai has established enforcement teams, considered monitoring architects and surveyors more closely, and discussed sharing sanctioned plans with neighbors to improve compliance. Overall, the document examines the current state of regulations and efforts to curb growing violations in Chennai's construction industry.
The document discusses major changes to building control and regulation in Israel, including:
1) A shift from an adversarial approach focused on investigating violations to a softer approach of instructing and guiding builders to comply with building codes.
2) Separation of spatial/planning control from design/building control and assigning them to separate entities to streamline the permitting process.
3) A change in perceptions around the permitting process, from committees providing free opinions on designs to compliance testing against predefined requirements and guidelines.
4) A renewed focus on enforcing building codes through oversight from design through completion to improve building quality and safety.
The document discusses various types of claims that can arise in construction contracts, including contractual claims, ex-contractual claims, and common law claims. It provides details on negative claims, which contractors can submit to avoid payments like liquidated damages, and positive claims, which contractors can submit for additional payment. The document outlines factors to consider when originating, preparing, and presenting claims, such as referring to relevant documents, proving disruption, calculating prolongation costs, and including overhead and profit.
The document is a city council agenda memorandum from the City Manager of Alamo Heights recommending authorizing an agreement with Overland Partners for architectural streetscape and landscaping design services for phase two of the Austin Highway/Lower Broadway improvement project for an amount not to exceed $120,000. Overland Partners was previously selected to develop visions and renderings for the project. Phase two services would further develop the design and ensure compatibility with engineering plans. The project is funded in the current fiscal year budget.
This document provides an analysis and professional advice for Smart Builder Construction regarding issues that arose on a construction project. It analyzes the issues based on the FIDIC Red Book 1999 and the PAM Contract 2006. Key issues included delayed site handover, non-payment of certificates, design changes incurring extra costs, and disputes over testing and defects. Advice is provided on the contractor's responsibilities, payment conditions, contractual programming, and dispute resolution methods. The contractor is advised to claim interest on late payments under the FIDIC Red Book and consider statutory adjudication for faster resolution of non-payment issues.
Item # 13 - Plan Review Process Revisionsahcitycouncil
The document discusses proposed revisions to the City of Alamo Heights plan review process that would allow applicants for residential, commercial, or multifamily projects to submit preliminary designs and identified variance requests to the Board of Adjustment for review before completing the full plan review process with staff. This change aims to reduce upfront costs for applicants by getting early Board feedback, though it could lengthen the overall approval timeline if modifications are later required after staff review.
The document is a contract agreement between parties for the design of a web site. It outlines the general description of work, payment details, deliverables, timetable and milestones. It also includes disclaimers, document history, contacts, and general terms around the work, payment, delivery and acceptance, licensing, and warranties. The purpose is to define the scope of work and terms for a web design project between the client and contractor.
The document is a city council agenda memorandum from the City Manager of Alamo Heights recommending approval of a resolution to authorize a professional services agreement with Overland Partners for architectural streetscape and landscape consulting services for the Austin Highway/Lower Broadway Improvement Project. The services would include developing streetscape plans and renderings, coordinating with other consultants and TxDOT, and providing deliverables to guide the project design, for a cost not to exceed $120,000 through September 2023. Background information provides details on Overland Partners' previous work on the project and the scope of services under the proposed agreement.
This document summarizes Cleveland's Fannie M. Lewis Cleveland Resident Employment Law, which requires that a minimum of 20% of total construction worker hours on city contracts over $100,000 be performed by Cleveland residents. It defines key terms, sets standards for contractor reporting and monitoring, and establishes penalties for noncompliance, including fines of up to 0.125% of the contract value. An advisory committee provides guidance to help achieve the law's goals of increasing resident employment in city-funded construction projects.
The Real Estate (Regulation & Development) Act 2016 established the Real Estate Regulatory Authority to regulate the real estate sector in a transparent manner and protect consumer interests. It requires registration of real estate projects with RERA, outlines promoter obligations like adhering to plans and timelines, and allottee rights. Key obligations on promoters include using 70% of funds for construction and rectifying defects. The Act aims to reduce delays in construction by ensuring clearances and funds for timely project completion, to the benefit of developers, buyers and the construction industry overall.
The document discusses the need for construction management plans (CMPs) for development projects in the new City. A CMP addresses aspects like public safety, work hours, noise and vibration controls, air and dust management, waste management, and traffic management. It provides guidance on when a CMP is required and its key elements. CMPs are required to minimize negative impacts on the community from construction work and ensure standards are met. The document outlines the CMP process and requirements to help builders and developers comply.
The document summarizes a staff report on potential amendments to building regulations relating to contractor registration, enforcement of residential construction projects, and declaring substandard structures. The report proposes strengthening requirements to ensure timely completion of residential projects and providing enforcement tools if projects are abandoned. Staff will present proposals to amend regulations on contractor registration and enforcement powers as well as allow declaring dangerous structures substandard.
The document summarizes a staff report on potential amendments to Chapter 5 of the city code relating to contractor registration requirements, enforcement tools for residential construction projects, and declaring substandard and dangerous structures. The staff report aims to ensure residential construction projects are completed on time and that the city has ways to enforce against projects that languish.
The document summarizes a staff report on potential amendments to Chapter 5 of the city code relating to contractor registration requirements, enforcement tools for residential construction projects, and declaring substandard and dangerous structures. The staff report aims to ensure residential construction projects are completed on time and that the city has enforcement measures if projects are abandoned.
The document provides an overview of the land development process in Cedar Park, Texas. It outlines the typical steps which include annexation, zoning, subdivision, permitting for site development, building, certificates of occupancy, and miscellaneous permits. For each step, it describes the purpose, typical milestones, and related resources. The comprehensive plan guides decisions around development proposals to establish a vision for Cedar Park based on community input.
This document outlines revised rules and regulations for implementing the Philippines' Build-Operate-Transfer (BOT) Law. Key points include:
- It recognizes the important role of the private sector in financing infrastructure projects normally undertaken by the government.
- The revised rules aim to provide incentives and support for project proponents, ensure transparency in project bidding, and ensure compliance by both government and private partners.
- It defines terms like BOT, Build-Lease-Transfer, and others and covers all private sector infrastructure projects undertaken through contractual arrangements authorized by the BOT Law.
This document provides a summary of site analysis and documentation prepared by a group of students. It includes an introduction to construction sites and building requirements. It also describes the importance of documentation for resolving disputes. Various aspects of the site are then covered, including building drawings, site layout, protection of trees, environmental considerations, hoarding, builders' sheds, and zoning. Definitions of key terms are also provided at the end.
This document provides definitions for key terms used in the Bangladesh National Building Code (BNBC) 2020. It defines terms related to building construction, design, administration and enforcement of building codes. Some key terms defined include building, alteration, approved plan, accessory use, basement, building line and building official. The definitions are intended to clarify terminology used throughout the BNBC 2020 document and its various parts related to building construction and regulation in Bangladesh.
The ordinance seeks to amend the actions of the Architectural Review Board (ARB) in the following ways:
1. Allow ARB recommendations to be made by a majority vote of members/alternates present instead of requiring 4 affirmative votes.
2. Clarify that the ARB makes recommendations to City Council regarding project designs.
3. Specify that City Council may approve, disapprove, or approve with modifications an ARB's project recommendation. Council may not refer applications back without additional information not previously considered.
The amendments aim to provide clearer recommendations from the ARB to City Council for timely decision making on development projects.
Contracts & Claims Management Workshop (Session-1)Tahir B Mirza
The document provides guidelines for identifying, documenting, and presenting construction claims. It discusses objectives of keeping accurate records to support potential claims related to delays, disruptions or other contract issues. Key points covered include rules of engagement for contractors, identifying claim-worthy events, maintaining thorough documentation, and properly establishing a claim's entitlement and quantum or monetary value. The presentation provided templates for organizing supporting records and a general format for submitting a formal claim, including an executive summary, entitlement and quantum analyses, and factual exhibits.
Obligations of promoters, penalties under RERABhavya Haria
An article on Obligations or promoters, penalties and compounding of offences under RERA published in CVOCA News and Views July 2017 - by Advocate Bhavya Haria
The document discusses major changes to building control and regulation in Israel, including:
1) A shift from an adversarial approach focused on investigating violations to a softer approach of instructing and guiding builders to comply with building codes.
2) Separation of spatial/planning control from design/building control and assigning them to separate entities to streamline the permitting process.
3) A change in perceptions around the permitting process, from committees providing free opinions on designs to compliance testing against predefined requirements and guidelines.
4) A renewed focus on enforcing building codes through oversight from design through completion to improve building quality and safety.
The document discusses various types of claims that can arise in construction contracts, including contractual claims, ex-contractual claims, and common law claims. It provides details on negative claims, which contractors can submit to avoid payments like liquidated damages, and positive claims, which contractors can submit for additional payment. The document outlines factors to consider when originating, preparing, and presenting claims, such as referring to relevant documents, proving disruption, calculating prolongation costs, and including overhead and profit.
The document is a city council agenda memorandum from the City Manager of Alamo Heights recommending authorizing an agreement with Overland Partners for architectural streetscape and landscaping design services for phase two of the Austin Highway/Lower Broadway improvement project for an amount not to exceed $120,000. Overland Partners was previously selected to develop visions and renderings for the project. Phase two services would further develop the design and ensure compatibility with engineering plans. The project is funded in the current fiscal year budget.
This document provides an analysis and professional advice for Smart Builder Construction regarding issues that arose on a construction project. It analyzes the issues based on the FIDIC Red Book 1999 and the PAM Contract 2006. Key issues included delayed site handover, non-payment of certificates, design changes incurring extra costs, and disputes over testing and defects. Advice is provided on the contractor's responsibilities, payment conditions, contractual programming, and dispute resolution methods. The contractor is advised to claim interest on late payments under the FIDIC Red Book and consider statutory adjudication for faster resolution of non-payment issues.
Item # 13 - Plan Review Process Revisionsahcitycouncil
The document discusses proposed revisions to the City of Alamo Heights plan review process that would allow applicants for residential, commercial, or multifamily projects to submit preliminary designs and identified variance requests to the Board of Adjustment for review before completing the full plan review process with staff. This change aims to reduce upfront costs for applicants by getting early Board feedback, though it could lengthen the overall approval timeline if modifications are later required after staff review.
The document is a contract agreement between parties for the design of a web site. It outlines the general description of work, payment details, deliverables, timetable and milestones. It also includes disclaimers, document history, contacts, and general terms around the work, payment, delivery and acceptance, licensing, and warranties. The purpose is to define the scope of work and terms for a web design project between the client and contractor.
The document is a city council agenda memorandum from the City Manager of Alamo Heights recommending approval of a resolution to authorize a professional services agreement with Overland Partners for architectural streetscape and landscape consulting services for the Austin Highway/Lower Broadway Improvement Project. The services would include developing streetscape plans and renderings, coordinating with other consultants and TxDOT, and providing deliverables to guide the project design, for a cost not to exceed $120,000 through September 2023. Background information provides details on Overland Partners' previous work on the project and the scope of services under the proposed agreement.
This document summarizes Cleveland's Fannie M. Lewis Cleveland Resident Employment Law, which requires that a minimum of 20% of total construction worker hours on city contracts over $100,000 be performed by Cleveland residents. It defines key terms, sets standards for contractor reporting and monitoring, and establishes penalties for noncompliance, including fines of up to 0.125% of the contract value. An advisory committee provides guidance to help achieve the law's goals of increasing resident employment in city-funded construction projects.
The Real Estate (Regulation & Development) Act 2016 established the Real Estate Regulatory Authority to regulate the real estate sector in a transparent manner and protect consumer interests. It requires registration of real estate projects with RERA, outlines promoter obligations like adhering to plans and timelines, and allottee rights. Key obligations on promoters include using 70% of funds for construction and rectifying defects. The Act aims to reduce delays in construction by ensuring clearances and funds for timely project completion, to the benefit of developers, buyers and the construction industry overall.
The document discusses the need for construction management plans (CMPs) for development projects in the new City. A CMP addresses aspects like public safety, work hours, noise and vibration controls, air and dust management, waste management, and traffic management. It provides guidance on when a CMP is required and its key elements. CMPs are required to minimize negative impacts on the community from construction work and ensure standards are met. The document outlines the CMP process and requirements to help builders and developers comply.
The document summarizes a staff report on potential amendments to building regulations relating to contractor registration, enforcement of residential construction projects, and declaring substandard structures. The report proposes strengthening requirements to ensure timely completion of residential projects and providing enforcement tools if projects are abandoned. Staff will present proposals to amend regulations on contractor registration and enforcement powers as well as allow declaring dangerous structures substandard.
The document summarizes a staff report on potential amendments to Chapter 5 of the city code relating to contractor registration requirements, enforcement tools for residential construction projects, and declaring substandard and dangerous structures. The staff report aims to ensure residential construction projects are completed on time and that the city has ways to enforce against projects that languish.
The document summarizes a staff report on potential amendments to Chapter 5 of the city code relating to contractor registration requirements, enforcement tools for residential construction projects, and declaring substandard and dangerous structures. The staff report aims to ensure residential construction projects are completed on time and that the city has enforcement measures if projects are abandoned.
The document provides an overview of the land development process in Cedar Park, Texas. It outlines the typical steps which include annexation, zoning, subdivision, permitting for site development, building, certificates of occupancy, and miscellaneous permits. For each step, it describes the purpose, typical milestones, and related resources. The comprehensive plan guides decisions around development proposals to establish a vision for Cedar Park based on community input.
This document outlines revised rules and regulations for implementing the Philippines' Build-Operate-Transfer (BOT) Law. Key points include:
- It recognizes the important role of the private sector in financing infrastructure projects normally undertaken by the government.
- The revised rules aim to provide incentives and support for project proponents, ensure transparency in project bidding, and ensure compliance by both government and private partners.
- It defines terms like BOT, Build-Lease-Transfer, and others and covers all private sector infrastructure projects undertaken through contractual arrangements authorized by the BOT Law.
This document provides a summary of site analysis and documentation prepared by a group of students. It includes an introduction to construction sites and building requirements. It also describes the importance of documentation for resolving disputes. Various aspects of the site are then covered, including building drawings, site layout, protection of trees, environmental considerations, hoarding, builders' sheds, and zoning. Definitions of key terms are also provided at the end.
This document provides definitions for key terms used in the Bangladesh National Building Code (BNBC) 2020. It defines terms related to building construction, design, administration and enforcement of building codes. Some key terms defined include building, alteration, approved plan, accessory use, basement, building line and building official. The definitions are intended to clarify terminology used throughout the BNBC 2020 document and its various parts related to building construction and regulation in Bangladesh.
The ordinance seeks to amend the actions of the Architectural Review Board (ARB) in the following ways:
1. Allow ARB recommendations to be made by a majority vote of members/alternates present instead of requiring 4 affirmative votes.
2. Clarify that the ARB makes recommendations to City Council regarding project designs.
3. Specify that City Council may approve, disapprove, or approve with modifications an ARB's project recommendation. Council may not refer applications back without additional information not previously considered.
The amendments aim to provide clearer recommendations from the ARB to City Council for timely decision making on development projects.
Contracts & Claims Management Workshop (Session-1)Tahir B Mirza
The document provides guidelines for identifying, documenting, and presenting construction claims. It discusses objectives of keeping accurate records to support potential claims related to delays, disruptions or other contract issues. Key points covered include rules of engagement for contractors, identifying claim-worthy events, maintaining thorough documentation, and properly establishing a claim's entitlement and quantum or monetary value. The presentation provided templates for organizing supporting records and a general format for submitting a formal claim, including an executive summary, entitlement and quantum analyses, and factual exhibits.
Obligations of promoters, penalties under RERABhavya Haria
An article on Obligations or promoters, penalties and compounding of offences under RERA published in CVOCA News and Views July 2017 - by Advocate Bhavya Haria
Similar to Item #s 3.4 - Contractor Compliance Regulations (20)
Preliminary findings _OECD field visits to ten regions in the TSI EU mining r...OECDregions
Preliminary findings from OECD field visits for the project: Enhancing EU Mining Regional Ecosystems to Support the Green Transition and Secure Mineral Raw Materials Supply.
UN WOD 2024 will take us on a journey of discovery through the ocean's vastness, tapping into the wisdom and expertise of global policy-makers, scientists, managers, thought leaders, and artists to awaken new depths of understanding, compassion, collaboration and commitment for the ocean and all it sustains. The program will expand our perspectives and appreciation for our blue planet, build new foundations for our relationship to the ocean, and ignite a wave of action toward necessary change.
The Antyodaya Saral Haryana Portal is a pioneering initiative by the Government of Haryana aimed at providing citizens with seamless access to a wide range of government services
Contributi dei parlamentari del PD - Contributi L. 3/2019Partito democratico
DI SEGUITO SONO PUBBLICATI, AI SENSI DELL'ART. 11 DELLA LEGGE N. 3/2019, GLI IMPORTI RICEVUTI DALL'ENTRATA IN VIGORE DELLA SUDDETTA NORMA (31/01/2019) E FINO AL MESE SOLARE ANTECEDENTE QUELLO DELLA PUBBLICAZIONE SUL PRESENTE SITO
RFP for Reno's Community Assistance CenterThis Is Reno
Property appraisals completed in May for downtown Reno’s Community Assistance and Triage Centers (CAC) reveal that repairing the buildings to bring them back into service would cost an estimated $10.1 million—nearly four times the amount previously reported by city staff.
Jennifer Schaus and Associates hosts a complimentary webinar series on The FAR in 2024. Join the webinars on Wednesdays and Fridays at noon, eastern.
Recordings are on YouTube and the company website.
https://www.youtube.com/@jenniferschaus/videos
Jennifer Schaus and Associates hosts a complimentary webinar series on The FAR in 2024. Join the webinars on Wednesdays and Fridays at noon, eastern.
Recordings are on YouTube and the company website.
https://www.youtube.com/@jenniferschaus/videos

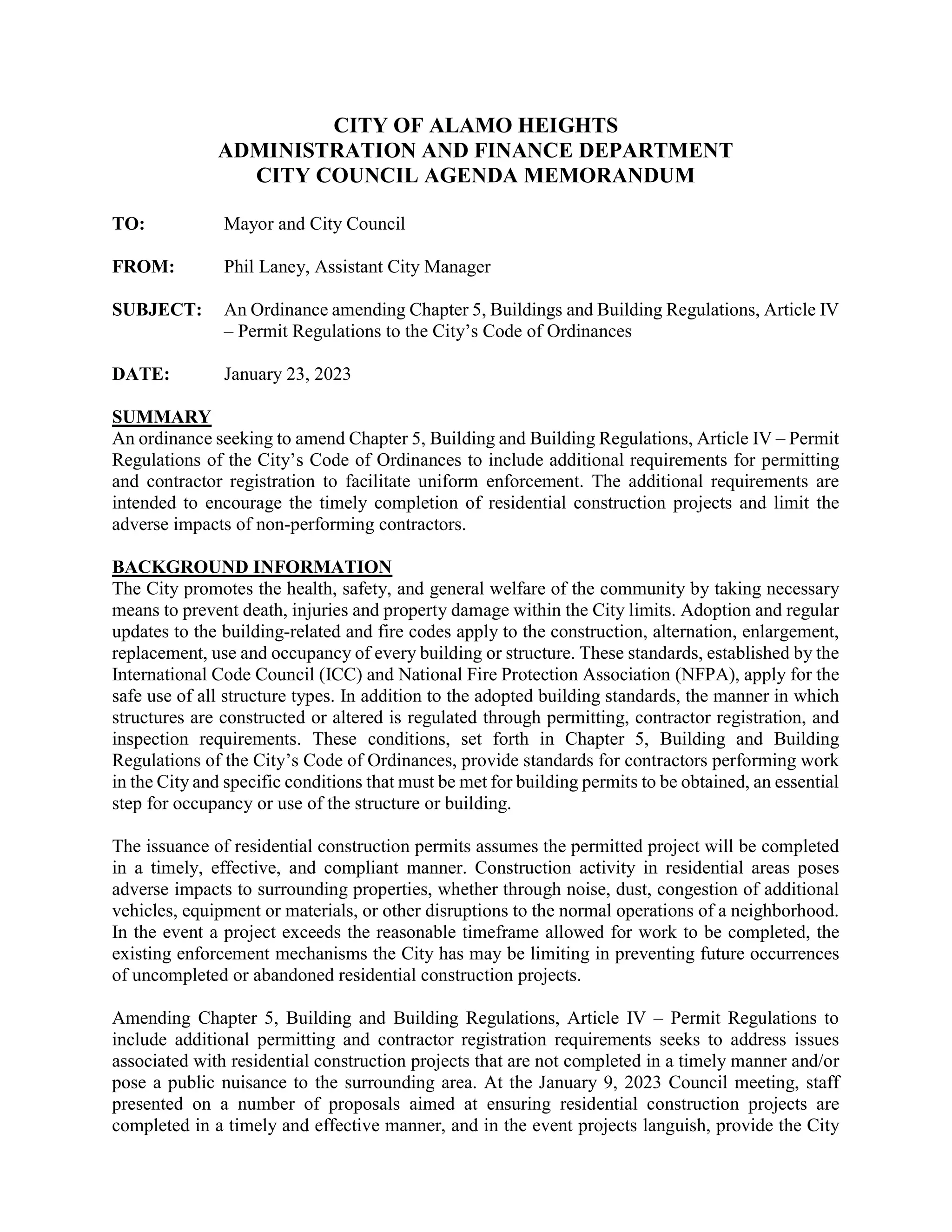

1. CITY OF ALAMO HEIGHTS
ADMINISTRATION AND FINANCE DEPARTMENT
CITY COUNCIL AGENDA MEMORANDUM
TO: Mayor and City Council
FROM: Phil Laney, Assistant City Manager
SUBJECT: An Ordinance amending Chapter 5, Buildings and Building Regulations, Article IV
– Permit Regulations to the City’s Code of Ordinances
DATE: January 23, 2023
SUMMARY
An ordinance seeking to amend Chapter 5, Building and Building Regulations, Article IV – Permit
Regulations of the City’s Code of Ordinances to include additional requirements for permitting
and contractor registration to facilitate uniform enforcement. The additional requirements are
intended to encourage the timely completion of residential construction projects and limit the
adverse impacts of non-performing contractors.
BACKGROUND INFORMATION
The City promotes the health, safety, and general welfare of the community by taking necessary
means to prevent death, injuries and property damage within the City limits. Adoption and regular
updates to the building-related and fire codes apply to the construction, alternation, enlargement,
replacement, use and occupancy of every building or structure. These standards, established by the
International Code Council (ICC) and National Fire Protection Association (NFPA), apply for the
safe use of all structure types. In addition to the adopted building standards, the manner in which
structures are constructed or altered is regulated through permitting, contractor registration, and
inspection requirements. These conditions, set forth in Chapter 5, Building and Building
Regulations of the City’s Code of Ordinances, provide standards for contractors performing work
in the City and specific conditions that must be met for building permits to be obtained, an essential
step for occupancy or use of the structure or building.
The issuance of residential construction permits assumes the permitted project will be completed
in a timely, effective, and compliant manner. Construction activity in residential areas poses
adverse impacts to surrounding properties, whether through noise, dust, congestion of additional
vehicles, equipment or materials, or other disruptions to the normal operations of a neighborhood.
In the event a project exceeds the reasonable timeframe allowed for work to be completed, the
existing enforcement mechanisms the City has may be limiting in preventing future occurrences
of uncompleted or abandoned residential construction projects.
Amending Chapter 5, Building and Building Regulations, Article IV – Permit Regulations to
include additional permitting and contractor registration requirements seeks to address issues
associated with residential construction projects that are not completed in a timely manner and/or
pose a public nuisance to the surrounding area. At the January 9, 2023 Council meeting, staff
presented on a number of proposals aimed at ensuring residential construction projects are
completed in a timely and effective manner, and in the event projects languish, provide the City

2. with appropriate enforcement measures to abate the nuisances. The feedback received from
Council is incorporated in the proposed amendments to Chapter 5.
The proposed amendment includes additional contractor and permitting registration requirements,
to include insurance requirements for contractors, affidavits submitted with the permit application,
and proof of the contractor’s registration with the City available at the work site. In the event a
contractor or project meets the offending criteria outlined in the amendment, the City may suspend
a permit or the contractor’s registration for a set time period or deem a person or entity ineligible
to receive new residential construction permits. These enforcement measures may be appealed to
the Board of Adjustment, who will issue the final decision.
POLICY ANALYSIS
The International Code Series establishes model codes and standards and building safety solutions
for all buildings and structures. The implementation of requirements associated with permitting,
inspections, and contractor registration provide the manner in which buildings and structures are
constructed and altered. The preservation of the community’s health, safety and welfare is a key
purpose of the City, and the inclusion of additional permitting and contractor registration
requirements strengthens the City’s ability to mitigate the likelihood of construction-related issues
while also providing the City additional tools to address such safety risks.
COORDINATION
Staff has reviewed the amendment with Mayor Pro Tem Jessee, the City Attorney, and the City
Manager.
FISCAL IMPACT
There is no fiscal impact on the City.
ATTACHMENTS
Attachment A – Draft Ordinance
______________________
Phil Laney
Assistant City Manager
______________________
Buddy Kuhn
City Manager

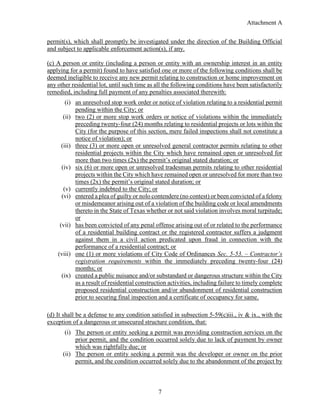

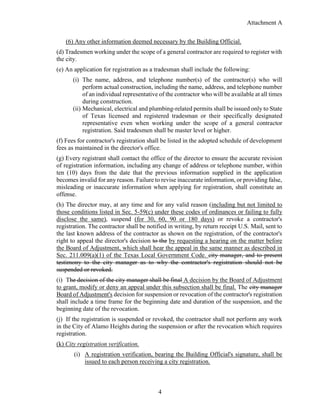

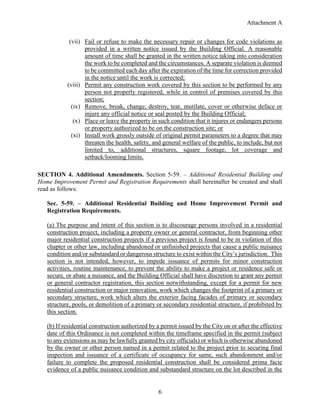

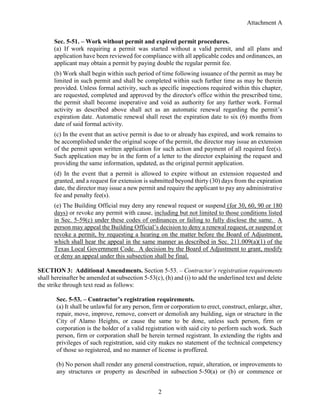

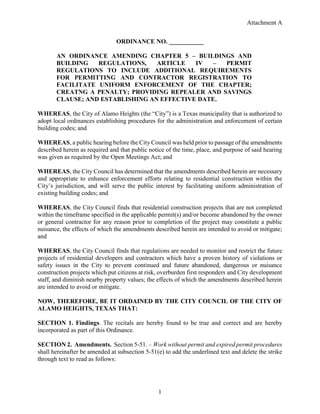

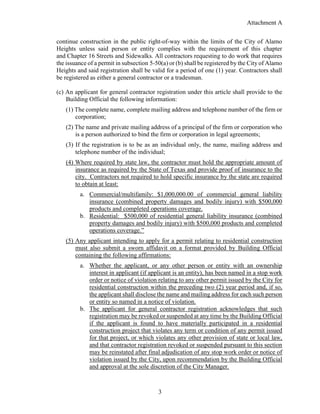

3. Attachment A
1
ORDINANCE NO. ___________
AN ORDINANCE AMENDING CHAPTER 5 – BUILDINGS AND
BUILDING REGULATIONS, ARTICLE IV – PERMIT
REGULATIONS TO INCLUDE ADDITIONAL REQUIREMENTS
FOR PERMITTING AND CONTRACTOR REGISTRATION TO
FACILITATE UNIFORM ENFORCEMENT OF THE CHAPTER;
CREATNG A PENALTY; PROVIDING REPEALER AND SAVINGS
CLAUSE; AND ESTABLISHING AN EFFECTIVE DATE.
WHEREAS, the City of Alamo Heights (the “City”) is a Texas municipality that is authorized to
adopt local ordinances establishing procedures for the administration and enforcement of certain
building codes; and
WHEREAS, a public hearing before the City Council was held prior to passage of the amendments
described herein as required and that public notice of the time, place, and purpose of said hearing
was given as required by the Open Meetings Act; and
WHEREAS, the City Council has determined that the amendments described herein are necessary
and appropriate to enhance enforcement efforts relating to residential construction within the
City’s jurisdiction, and will serve the public interest by facilitating uniform administration of
existing building codes; and
WHEREAS, the City Council finds that residential construction projects that are not completed
within the timeframe specified in the applicable permit(s) and/or become abandoned by the owner
or general contractor for any reason prior to completion of the project may constitute a public
nuisance, the effects of which the amendments described herein are intended to avoid or mitigate;
and
WHEREAS, the City Council finds that regulations are needed to monitor and restrict the future
projects of residential developers and contractors which have a proven history of violations or
safety issues in the City to prevent continued and future abandoned, dangerous or nuisance
construction projects which put citizens at risk, overburden first responders and City development
staff, and diminish nearby property values; the effects of which the amendments described herein
are intended to avoid or mitigate.
NOW, THEREFORE, BE IT ORDAINED BY THE CITY COUNCIL OF THE CITY OF
ALAMO HEIGHTS, TEXAS THAT:
SECTION 1. Findings. The recitals are hereby found to be true and correct and are hereby
incorporated as part of this Ordinance.
SECTION 2. Amendments. Section 5-51. – Work without permit and expired permit procedures
shall hereinafter be amended at subsection 5-51(e) to add the underlined text and delete the strike
through text to read as follows:
4. Attachment A
2
Sec. 5-51. – Work without permit and expired permit procedures.
(a) If work requiring a permit was started without a valid permit, and all plans and
application have been reviewed for compliance with all applicable codes and ordinances, an
applicant may obtain a permit by paying double the regular permit fee.
(b) Work shall begin within such period of time following issuance of the permit as may be
limited in such permit and shall be completed within such further time as may be therein
provided. Unless formal activity, such as specific inspections required within this chapter,
are requested, completed and approved by the director's office within the prescribed time,
the permit shall become inoperative and void as authority for any further work. Formal
activity as described above shall act as an automatic renewal regarding the permit’s
expiration date. Automatic renewal shall reset the expiration date to six (6) months from
date of said formal activity.
(c) In the event that an active permit is due to or already has expired, and work remains to
be accomplished under the original scope of the permit, the director may issue an extension
of the permit upon written application for such action and payment of all required fee(s).
Such application may be in the form of a letter to the director explaining the request and
providing the same information, updated, as the original permit application.
(d) In the event that a permit is allowed to expire without an extension requested and
granted, and a request for extension is submitted beyond thirty (30) days from the expiration
date, the director may issue a new permit and require the applicant to pay any administrative
fee and penalty fee(s).
(e) The Building Official may deny any renewal request or suspend (for 30, 60, 90 or 180
days) or revoke any permit with cause, including but not limited to those conditions listed
in Sec. 5-59(c) under these codes of ordinances or failing to fully disclose the same. A
person may appeal the Building Official’s decision to deny a renewal request, or suspend or
revoke a permit, by requesting a hearing on the matter before the Board of Adjustment,
which shall hear the appeal in the same manner as described in Sec. 211.009(a)(1) of the
Texas Local Government Code. A decision by the Board of Adjustment to grant, modify
or deny an appeal under this subsection shall be final.
SECTION 3: Additional Amendments. Section 5-53. – Contractor’s registration requirements
shall hereinafter be amended at subsection 5-53(c), (h) and (i) to add the underlined text and delete
the strike through text read as follows:
Sec. 5-53. – Contractor’s registration requirements.
(a) It shall be unlawful for any person, firm or corporation to erect, construct, enlarge, alter,
repair, move, improve, remove, convert or demolish any building, sign or structure in the
City of Alamo Heights, or cause the same to be done, unless such person, firm or
corporation is the holder of a valid registration with said city to perform such work. Such
person, firm or corporation shall be herein termed registrant. In extending the rights and
privileges of such registration, said city makes no statement of the technical competency
of those so registered, and no manner of license is proffered.
(b) No person shall render any general construction, repair, alteration, or improvements to
any structures or property as described in subsection 5-50(a) or (b) or commence or
5. Attachment A
3
continue construction in the public right-of-way within the limits of the City of Alamo
Heights unless said person or entity complies with the requirement of this chapter
and Chapter 16 Streets and Sidewalks. All contractors requesting to do work that requires
the issuance of a permit in subsection 5-50(a) or (b) shall be registered by the City of Alamo
Heights and said registration shall be valid for a period of one (1) year. Contractors shall
be registered as either a general contractor or a tradesman.
(c) An applicant for general contractor registration under this article shall provide to the
Building Official the following information:
(1) The complete name, complete mailing address and telephone number of the firm or
corporation;
(2) The name and private mailing address of a principal of the firm or corporation who
is a person authorized to bind the firm or corporation in legal agreements;
(3) If the registration is to be as an individual only, the name, mailing address and
telephone number of the individual;
(4) Where required by state law, the contractor must hold the appropriate amount of
insurance as required by the State of Texas and provide proof of insurance to the
city. Contractors not required to hold specific insurance by the state are required
to obtain at least:
a. Commercial/multifamily: $1,000,000.00 of commercial general liability
insurance (combined property damages and bodily injury) with $500,000
products and completed operations coverage.
b. Residential: $500,000 of residential general liability insurance (combined
property damages and bodily injury) with $500,000 products and completed
operations coverage.”
(5) Any applicant intending to apply for a permit relating to residential construction
must also submit a sworn affidavit on a format provided by Building Official
containing the following affirmations:
a. Whether the applicant, or any other person or entity with an ownership
interest in applicant (if applicant is an entity), has been named in a stop work
order or notice of violation relating to any other permit issued by the City for
residential construction within the preceding two (2) year period and, if so,
the applicant shall disclose the name and mailing address for each such person
or entity so named in a notice of violation.
b. The applicant for general contractor registration acknowledges that such
registration may be revoked or suspended at any time by the Building Official
if the applicant is found to have materially participated in a residential
construction project that violates any term or condition of any permit issued
for that project, or which violates any other provision of state or local law,
and that contractor registration revoked or suspended pursuant to this section
may be reinstated after final adjudication of any stop work order or notice of
violation issued by the City, upon recommendation by the Building Official
and approval at the sole discretion of the City Manager.
6. Attachment A
4
(6) Any other information deemed necessary by the Building Official.
(d) Tradesmen working under the scope of a general contractor are required to register with
the city.
(e) An application for registration as a tradesman shall include the following:
(i) The name, address, and telephone number(s) of the contractor(s) who will
perform actual construction, including the name, address, and telephone number
of an individual representative of the contractor who will be available at all times
during construction.
(ii) Mechanical, electrical and plumbing-related permits shall be issued only to State
of Texas licensed and registered tradesman or their specifically designated
representative even when working under the scope of a general contractor
registration. Said tradesmen shall be master level or higher.
(f) Fees for contractor's registration shall be listed in the adopted schedule of development
fees as maintained in the director's office.
(g) Every registrant shall contact the office of the director to ensure the accurate revision
of registration information, including any change of address or telephone number, within
ten (10) days from the date that the previous information supplied in the application
becomes invalid for any reason. Failure to revise inaccurate information, or providing false,
misleading or inaccurate information when applying for registration, shall constitute an
offense.
(h) The director may, at any time and for any valid reason (including but not limited to
those conditions listed in Sec. 5-59(c) under these codes of ordinances or failing to fully
disclose the same), suspend (for 30, 60, 90 or 180 days) or revoke a contractor's
registration. The contractor shall be notified in writing, by return receipt U.S. Mail, sent to
the last known address of the contractor as shown on the registration, of the contractor's
right to appeal the director's decision to the by requesting a hearing on the matter before
the Board of Adjustment, which shall hear the appeal in the same manner as described in
Sec. 211.009(a)(1) of the Texas Local Government Code. city manager, and to present
testimony to the city manager as to why the contractor's registration should not be
suspended or revoked.
(i) The decision of the city manager shall be final A decision by the Board of Adjustment
to grant, modify or deny an appeal under this subsection shall be final. The city manager
Board of Adjustment's decision for suspension or revocation of the contractor's registration
shall include a time frame for the beginning date and duration of the suspension, and the
beginning date of the revocation.
(j) If the registration is suspended or revoked, the contractor shall not perform any work
in the City of Alamo Heights during the suspension or after the revocation which requires
registration.
(k) City registration verification.
(i) A registration verification, bearing the Building Official's signature, shall be
issued to each person receiving a city registration.
7. Attachment A
5
(ii) Registrations shall be renewed prior to the expiration date. Each person holding
a valid registration shall renew same in sufficient time to have the renewal form
returned to the development services department with the appropriate renewal
fee prior the expiration date. All city registrations shall expire one (1) year after
issuance. Registrations shall be renewed prior to expiration date. Each person
holding a valid registration shall renew same in sufficient time to have the
renewal form and insurance information returned to the department with the
appropriate renewal fee prior to registration expiration date.
(iii) Each registration verification, when issued to a contractor, shall be issued to a
person and registered in the name of the firm by which the person is employed.
The firm shall be known as the holder of such registration and shall notify the
code official if the registration holder is no longer in its employment. No further
permits will be issued to the firm based upon the previous registration holder's
name who is no longer employed by the firm.
(iv) It shall be a violation of this Code for any person to alter or amend in any
manner, lend, rent, or transfer a registration verification, and for any person to
make use of any such rights for which the person is not registered.
(v) Each holder of a city issued verification shall carry registration verification in
a format to be designated by the Building Official on his person at all times
while performing construction work covered by this Code and shall present it
to the Building Official upon demand.
(vi) The Building Official is hereby authorized to preserve, alter or amend any
documents necessary to effectuate the intent and purpose of this subsection.
(l) Registrations not transferable. No registration shall be transferred and no holder of any
registration shall allow his name or registration to be used by any other person, either for
the purpose of performing construction work or obtaining a permit under the penalty of
forfeiture of registration and payment of fines.
(m)Violations under this section. The following list shall constitute a non-exclusive list of
violations under this section. It is unlawful for any registered contractor to:
(i) Display or cause a permit to be displayed or to have in one's possession a
registration for doing any construction work, knowing it to be fictitious or to
have been canceled, suspended or altered;
(ii) Lend or permit the use of any registration for doing any construction work to
any person not entitled to it;
(iii) Allow any person to display or to represent as one's own city registration for
any construction work when the registration has not been lawfully issued to the
person displaying it;
(iv) Use a false or fictitious name or address in any application for any registration
or permit provided for in this chapter or any renewal or make a false statement
or conceal a material fact or otherwise commit fraud in making any application;
(v) Perform any contractor work for which a registration is required without having
the registration or while the registration is suspended, expired or canceled;
(vi) Perform any work for which a permit is required without having the permit or
after the permit has been canceled;
8. Attachment A
6
(vii) Fail or refuse to make the necessary repair or changes for code violations as
provided in a written notice issued by the Building Official. A reasonable
amount of time shall be granted in the written notice taking into consideration
the work to be completed and the circumstances. A separate violation is deemed
to be committed each day after the expiration of the time for correction provided
in the notice until the work is corrected;
(viii) Permit any construction work covered by this section to be performed by any
person not properly registered, while in control of premises covered by this
section;
(ix) Remove, break, change, destroy, tear, mutilate, cover or otherwise deface or
injure any official notice or seal posted by the Building Official;
(x) Place or leave the property in such condition that it injures or endangers persons
or property authorized to be on the construction site; or
(xi) Install work grossly outside of original permit parameters to a degree that may
threaten the health, safety, and general welfare of the public, to include, but not
limited to, additional structures, square footage, lot coverage and
setback/looming limits.
SECTION 4. Additional Amendments. Section 5-59. – Additional Residential Building and
Home Improvement Permit and Registration Requirements shall hereinafter be created and shall
read as follows:
Sec. 5-59. – Additional Residential Building and Home Improvement Permit and
Registration Requirements.
(a) The purpose and intent of this section is to discourage persons involved in a residential
construction project, including a property owner or general contractor, from beginning other
major residential construction projects if a previous project is found to be in violation of this
chapter or other law, including abandoned or unfinished projects that cause a public nuisance
condition and/or substandard or dangerous structure to exist within the City’s jurisdiction. This
section is not intended, however, to impede issuance of permits for minor construction
activities, routine maintenance, to prevent the ability to make a project or residence safe or
secure, or abate a nuisance, and the Building Official shall have discretion to grant any permit
or general contractor registration, this section notwithstanding, except for a permit for new
residential construction or major renovation, work which changes the footprint of a primary or
secondary structure, work which alters the exterior facing facades of primary or secondary
structure, pools, or demolition of a primary or secondary residential structure, if prohibited by
this section.
(b) If residential construction authorized by a permit issued by the City on or after the effective
date of this Ordinance is not completed within the timeframe specified in the permit (subject
to any extensions as may be lawfully granted by city officials) or which is otherwise abandoned
by the owner or other person named in a permit related to the project prior to securing final
inspection and issuance of a certificate of occupancy for same, such abandonment and/or
failure to complete the proposed residential construction shall be considered prima facie
evidence of a public nuisance condition and substandard structure on the lot described in the
9. Attachment A
7
permit(s), which shall promptly be investigated under the direction of the Building Official
and subject to applicable enforcement action(s), if any.
(c) A person or entity (including a person or entity with an ownership interest in an entity
applying for a permit) found to have satisfied one or more of the following conditions shall be
deemed ineligible to receive any new permit relating to construction or home improvement on
any other residential lot, until such time as all the following conditions have been satisfactorily
remedied, including full payment of any penalties associated therewith:
(i) an unresolved stop work order or notice of violation relating to a residential permit
pending within the City; or
(ii) two (2) or more stop work orders or notice of violations within the immediately
preceding twenty-four (24) months relating to residential projects or lots within the
City (for the purpose of this section, mere failed inspections shall not constitute a
notice of violation); or
(iii) three (3) or more open or unresolved general contractor permits relating to other
residential projects within the City which have remained open or unresolved for
more than two times (2x) the permit’s original stated duration; or
(iv) six (6) or more open or unresolved tradesman permits relating to other residential
projects within the City which have remained open or unresolved for more than two
times (2x) the permit’s original stated duration; or
(v) currently indebted to the City; or
(vi) entered a plea of guilty or nolo contendere (no contest) or been convicted of a felony
or misdemeanor arising out of a violation of the building code or local amendments
thereto in the State of Texas whether or not said violation involves moral turpitude;
or
(vii) has been convicted of any penal offense arising out of or related to the performance
of a residential building contract or the registered contractor suffers a judgment
against them in a civil action predicated upon fraud in connection with the
performance of a residential contract; or
(viii) one (1) or more violations of City Code of Ordinances Sec. 5-53. – Contractor’s
registration requirements within the immediately preceding twenty-four (24)
months; or
(ix) created a public nuisance and/or substandard or dangerous structure within the City
as a result of residential construction activities, including failure to timely complete
proposed residential construction and/or abandonment of residential construction
prior to securing final inspection and a certificate of occupancy for same.
(d) It shall be a defense to any condition satisfied in subsection 5-59(c)iii., iv & ix., with the
exception of a dangerous or unsecured structure condition, that:
(i) The person or entity seeking a permit was providing construction services on the
prior permit, and the condition occurred solely due to lack of payment by owner
which was rightfully due; or
(ii) The person or entity seeking a permit was the developer or owner on the prior
permit, and the condition occurred solely due to the abandonment of the project by
10. Attachment A
8
contractor, and less than one-hundred and eighty (180) days has passed since said
abandonment.
SECTION 5. Conflicting Ordinances or Resolutions. All resolutions or ordinances or parts
thereof conflicting or inconsistent with the provisions of this ordinance as adopted and amended
herein, are hereby REPEALED to the extent of such conflict. In the event of a conflict or
inconsistency between this ordinance and any other resolution, code or ordinance of the City, or
parts thereof, the terms and provisions of this ordinance shall govern.
SECTION 6. Severability. If any section, subsection, clause, phrase, or word of this ordinance is
declared unconstitutional or invalid for any purpose, the remainder of this ordinance shall not be
affected thereby and to this end the provisions of this ordinance are declared to be severable.
SECTION 7. Open Meetings. It is hereby officially found and determined that the meeting at
which this ordinance is passed was open to the public as required and that public notice of the
time, place, and purpose of said meeting was given as required by the Open Meetings Act.
SECTION 8. Effective Date. This ordinance shall be effective from and after its approval and
passage in accordance with the Texas Local Government Code and the city charter.
PRESENTED AND APPROVED BY THE CITY COUNCIL OF THE CITY OF ALAMO
HEIGHTS, TEXAS THIS ______ DAY OF _________________ 2023.
BOBBY ROSENTHAL, MAYOR
ATTEST:
ELSA T. ROBLES, CITY SECRETARY
APPROVED AS TO FORM:
FRANK J. GARZA, CITY ATTORNEY
