Introduction to the Engineering and
Construction Contract (ECC)
Delivering
real value
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 2
NEC4: Introduction to the Engineering and
Construction Contract (ECC)
Introduction and housekeeping
 Fire alarms
 Toilets
 Breaks and lunch
 Who am I?
 Who are you?

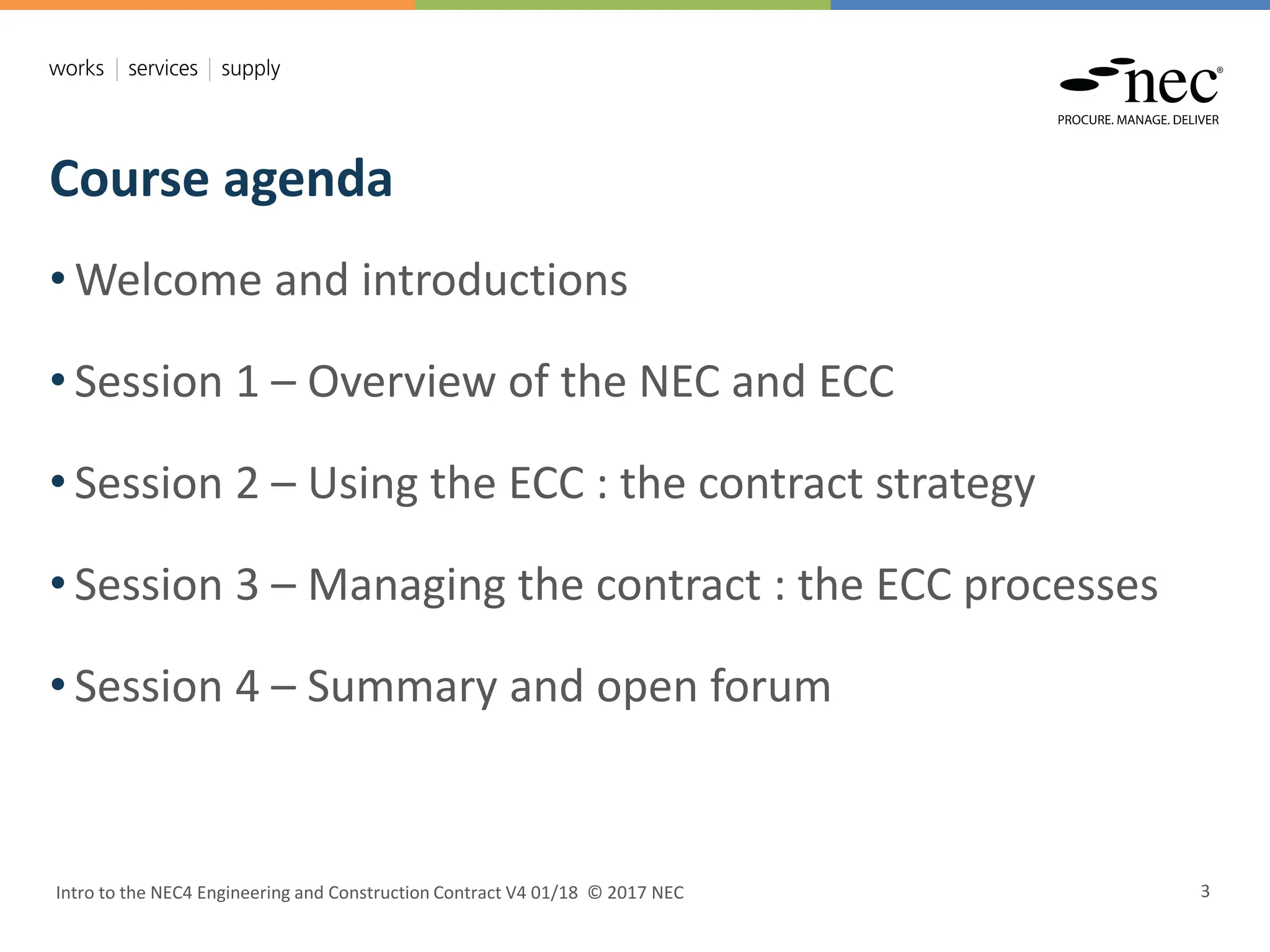

Course agenda
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 3
• Welcome and introductions
• Session 1 – Overview of the NEC and ECC
• Session 2 – Using the ECC : the contract strategy
• Session 3 – Managing the contract : the ECC processes
• Session 4 – Summary and open forum

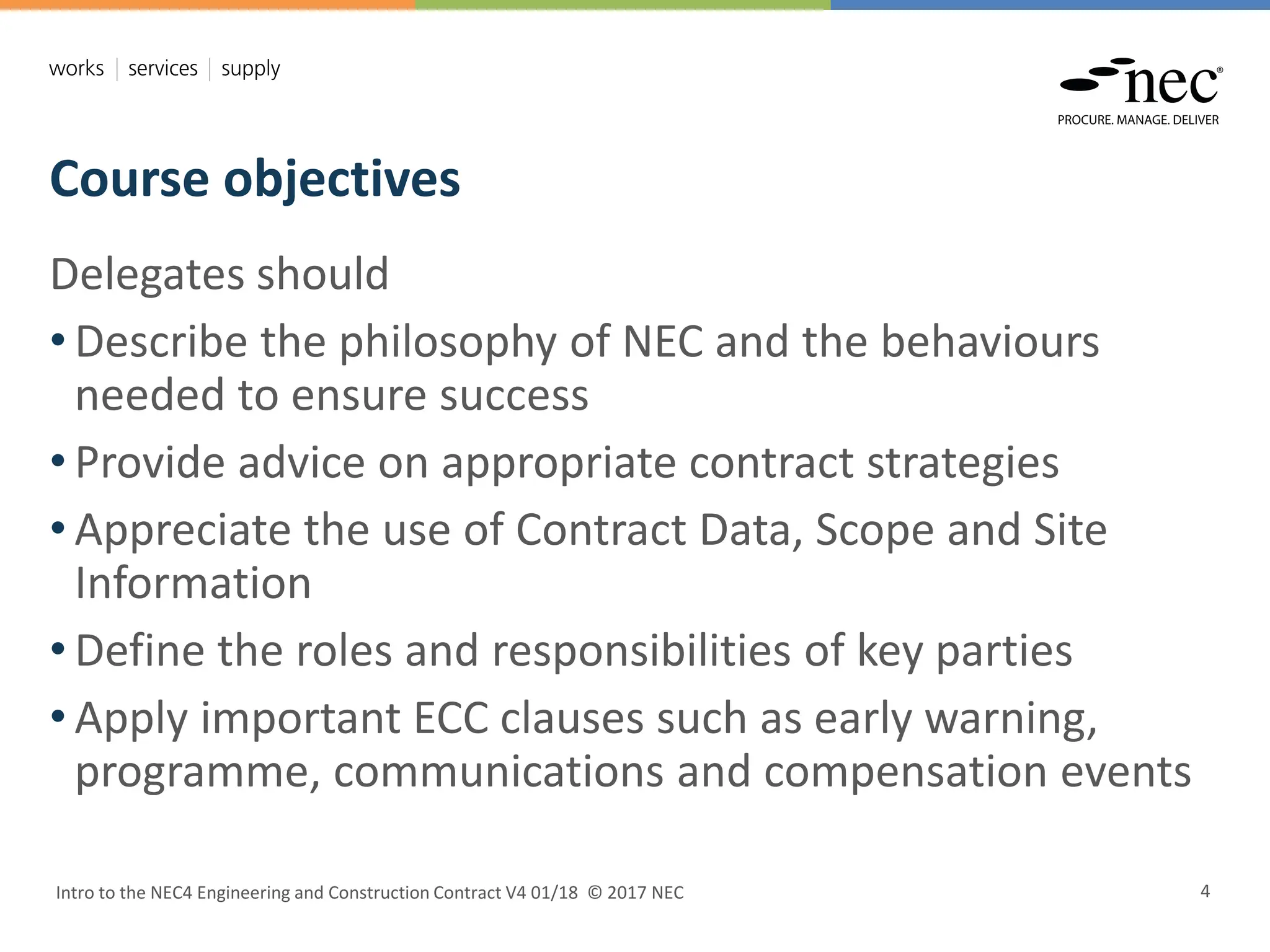

Course objectives
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 4
Delegates should
• Describe the philosophy of NEC and the behaviours
needed to ensure success
• Provide advice on appropriate contract strategies
• Appreciate the use of Contract Data, Scope and Site
Information
• Define the roles and responsibilities of key parties
• Apply important ECC clauses such as early warning,
programme, communications and compensation events
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 5
Session 1 – Overview of the NEC
The NEC principles and family - review
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 6
Review
Principles
Documents
& contracts
ECSC
ECS &
ECSS
Culture
People

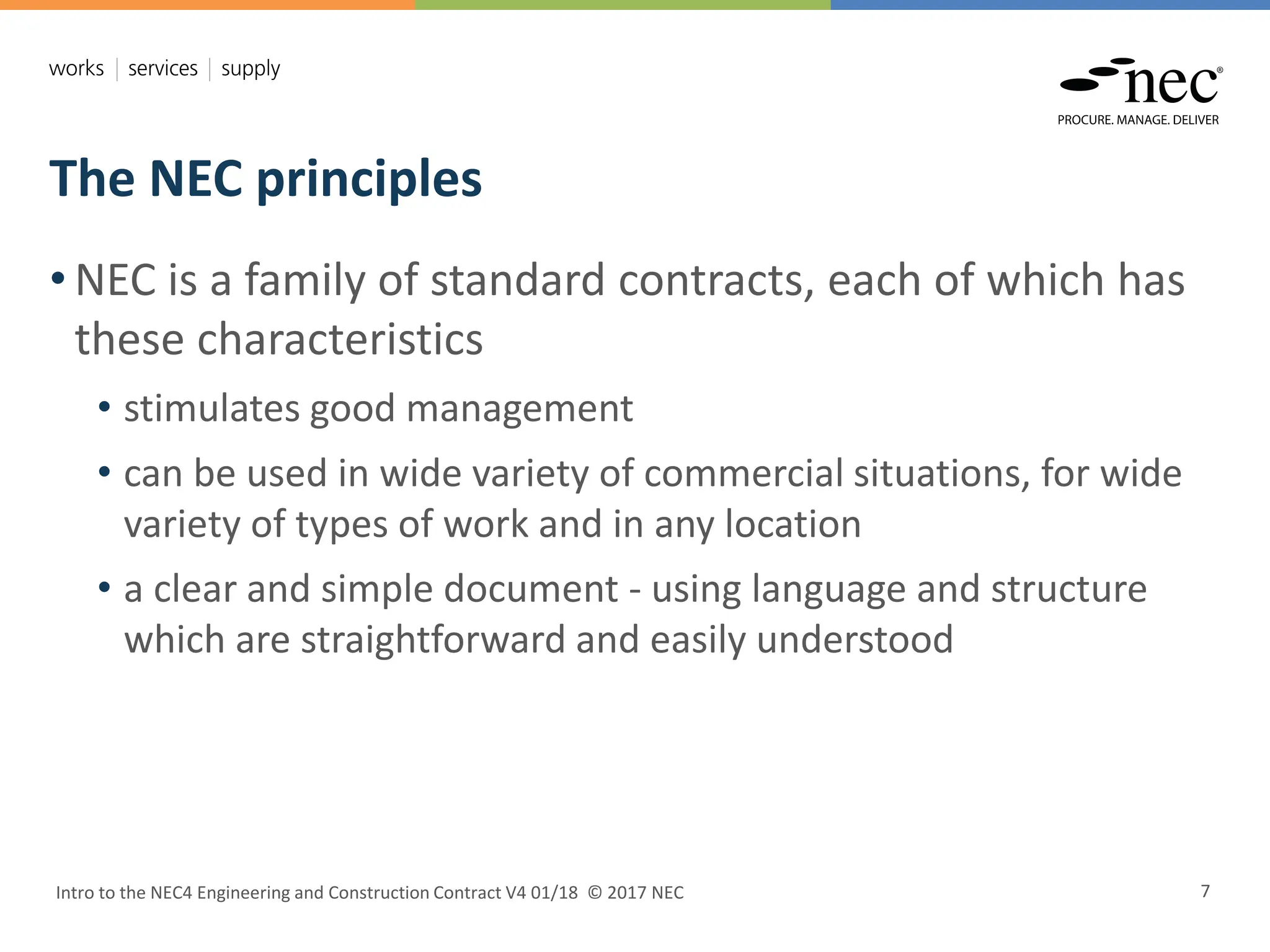

The NEC principles
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 7
• NEC is a family of standard contracts, each of which has
these characteristics
• stimulates good management
• can be used in wide variety of commercial situations, for wide
variety of types of work and in any location
• a clear and simple document - using language and structure
which are straightforward and easily understood

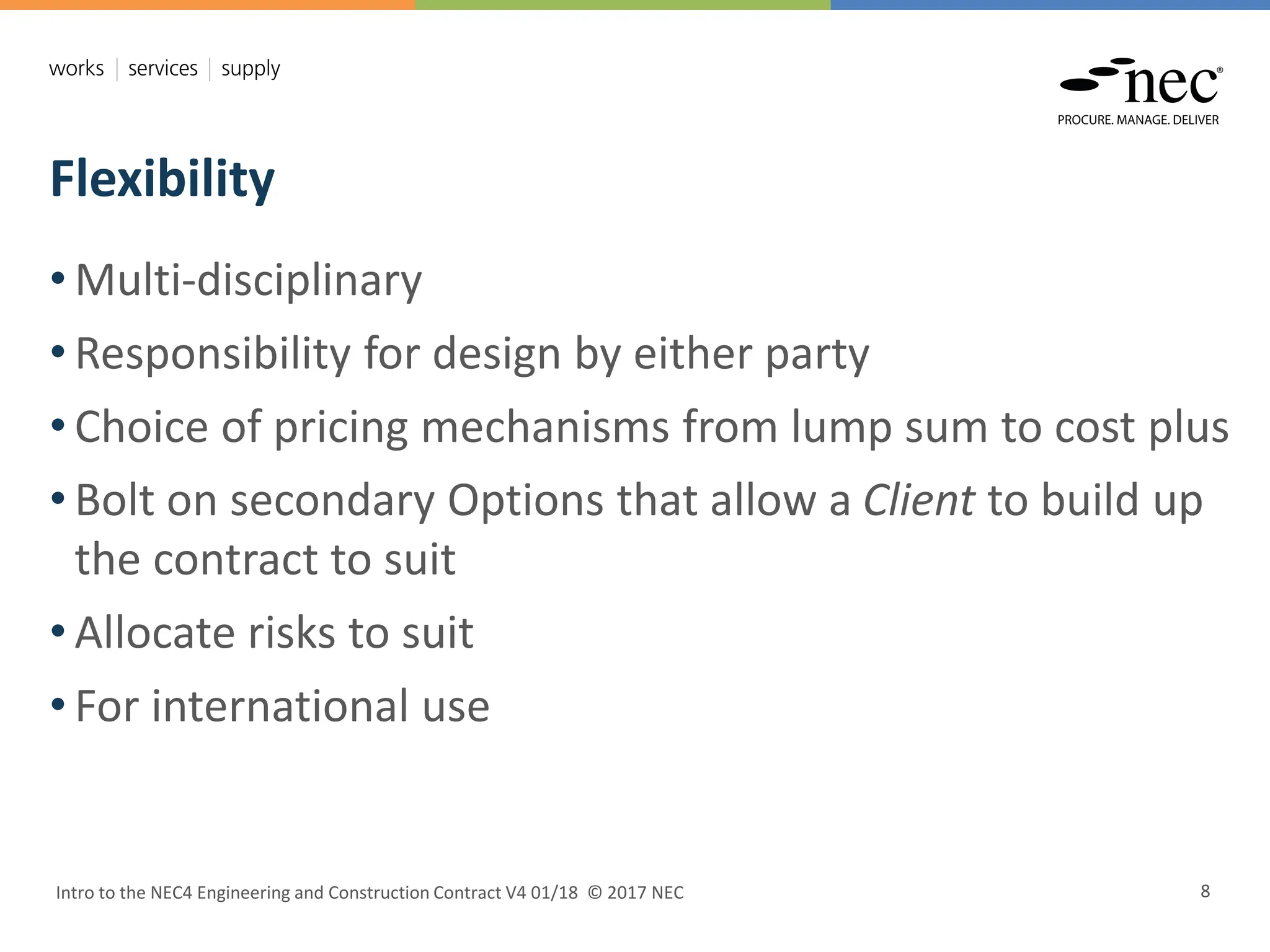

Flexibility
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 8
• Multi-disciplinary
• Responsibility for design by either party
• Choice of pricing mechanisms from lump sum to cost plus
• Bolt on secondary Options that allow a Client to build up
the contract to suit
• Allocate risks to suit
• For international use

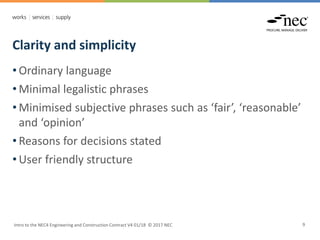

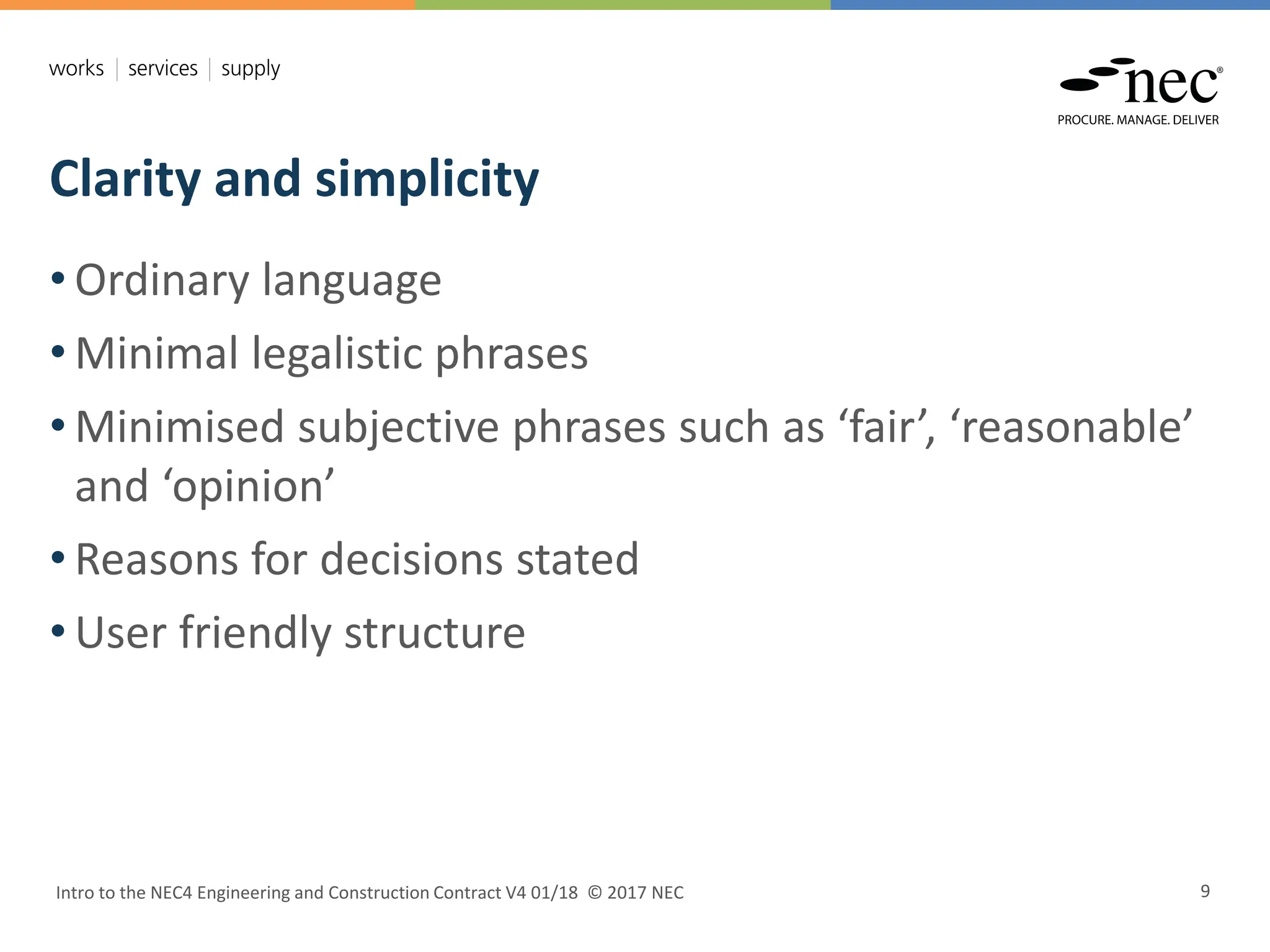

Clarity and simplicity
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 9
• Ordinary language
• Minimal legalistic phrases
• Minimised subjective phrases such as ‘fair’, ‘reasonable’
and ‘opinion’
• Reasons for decisions stated
• User friendly structure

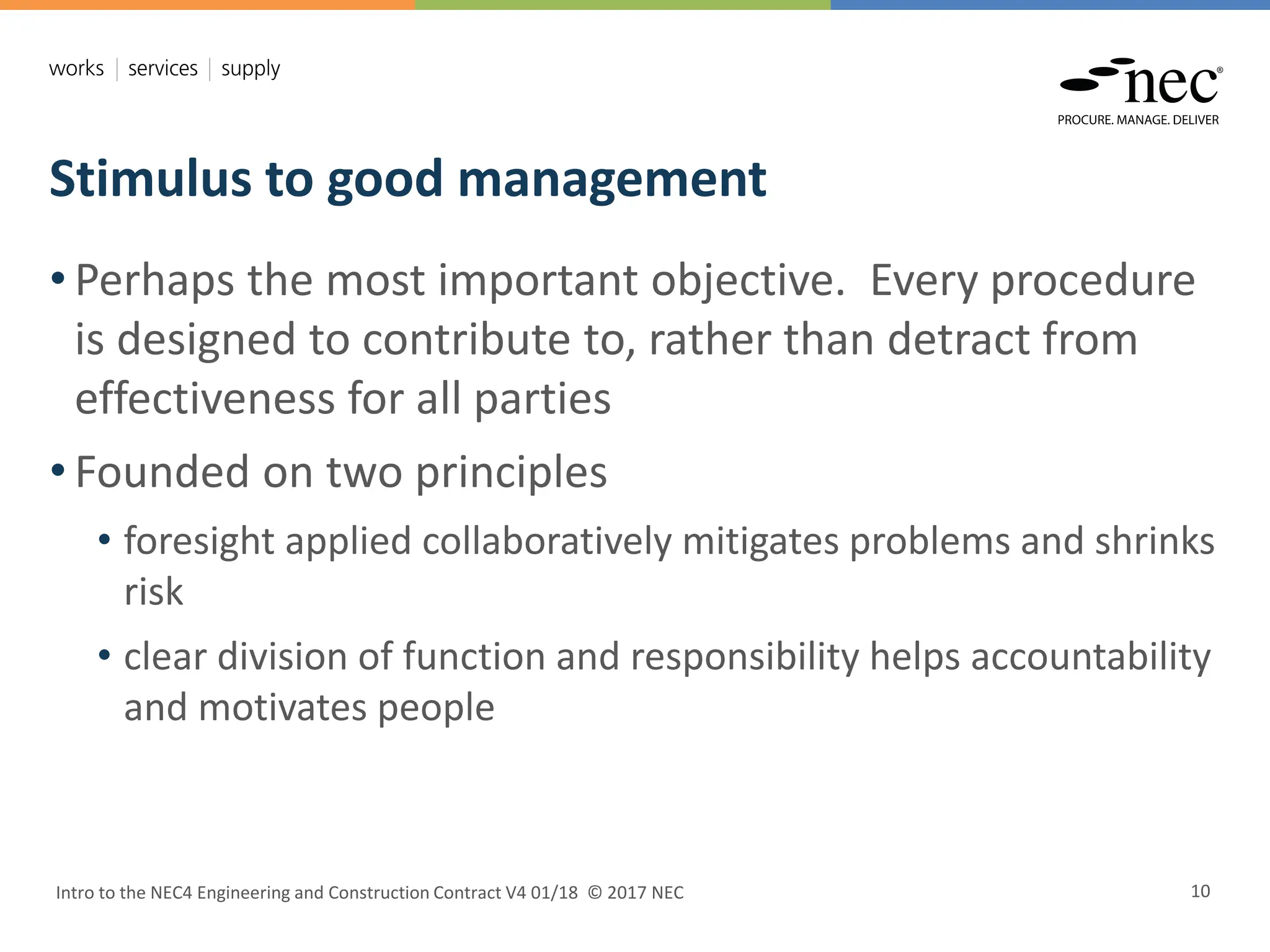

Stimulus to good management
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 10
• Perhaps the most important objective. Every procedure
is designed to contribute to, rather than detract from
effectiveness for all parties
• Founded on two principles
• foresight applied collaboratively mitigates problems and shrinks
risk
• clear division of function and responsibility helps accountability
and motivates people
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 11

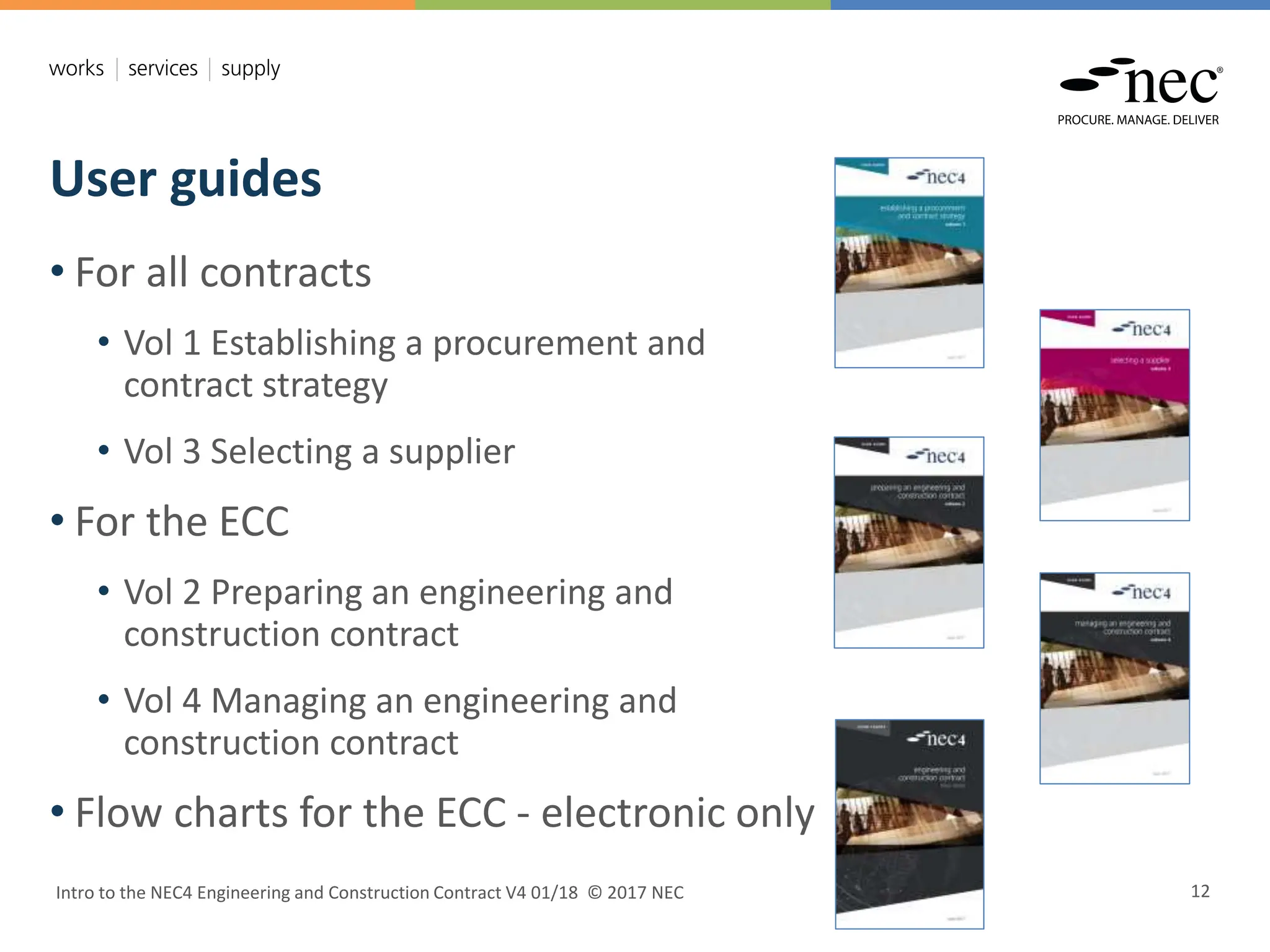

User guides
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 12
• For all contracts
• Vol 1 Establishing a procurement and
contract strategy
• Vol 3 Selecting a supplier
• For the ECC
• Vol 2 Preparing an engineering and
construction contract
• Vol 4 Managing an engineering and
construction contract

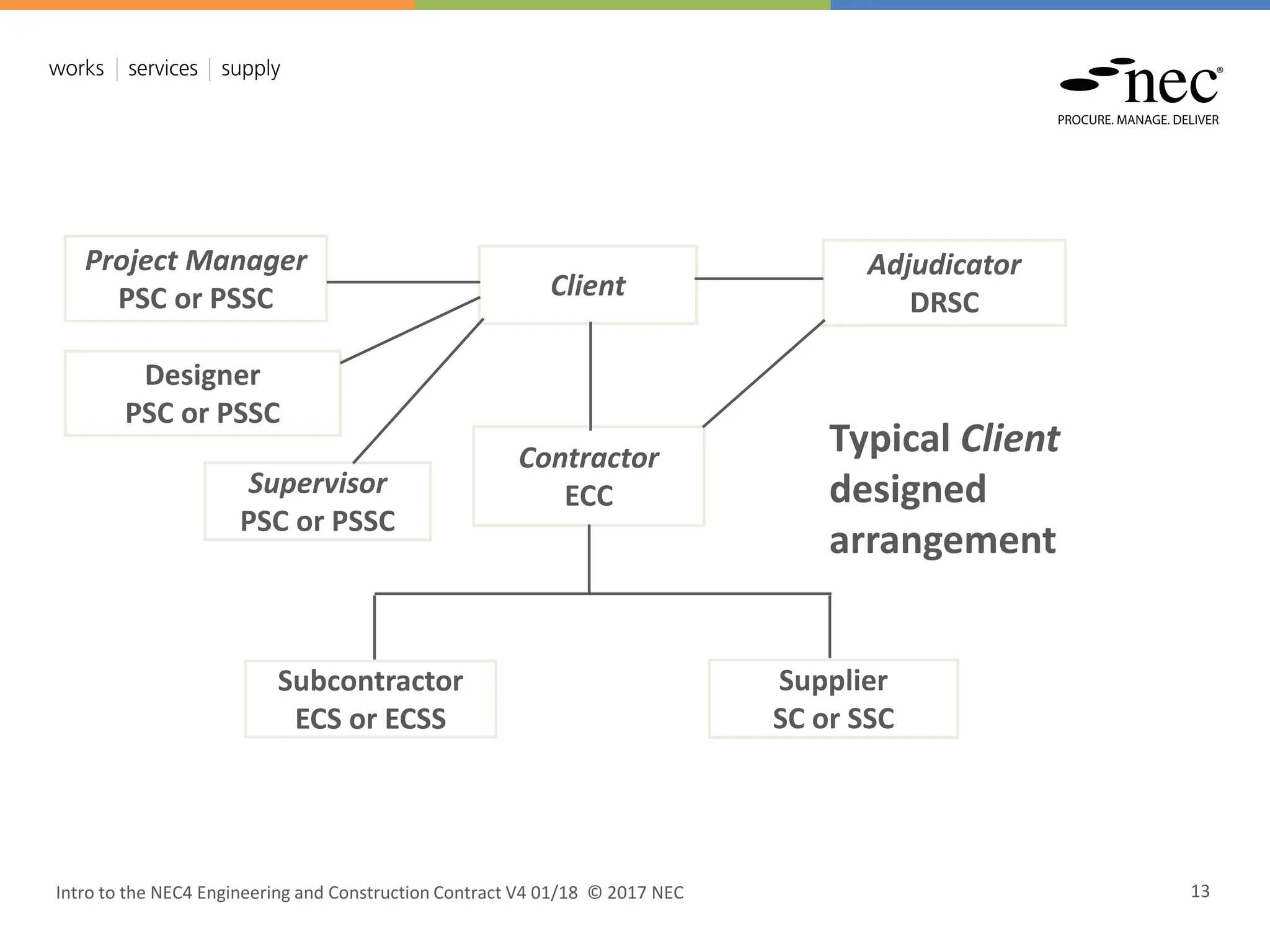

• Flow charts for the ECC - electronic only
Client
Project Manager
PSC or PSSC
Contractor
ECC
Adjudicator
DRSC
Supplier
SC or SSC
Subcontractor
ECS or ECSS
Supervisor
PSC or PSSC
Designer
PSC or PSSC
Typical Client
designed
arrangement
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 13

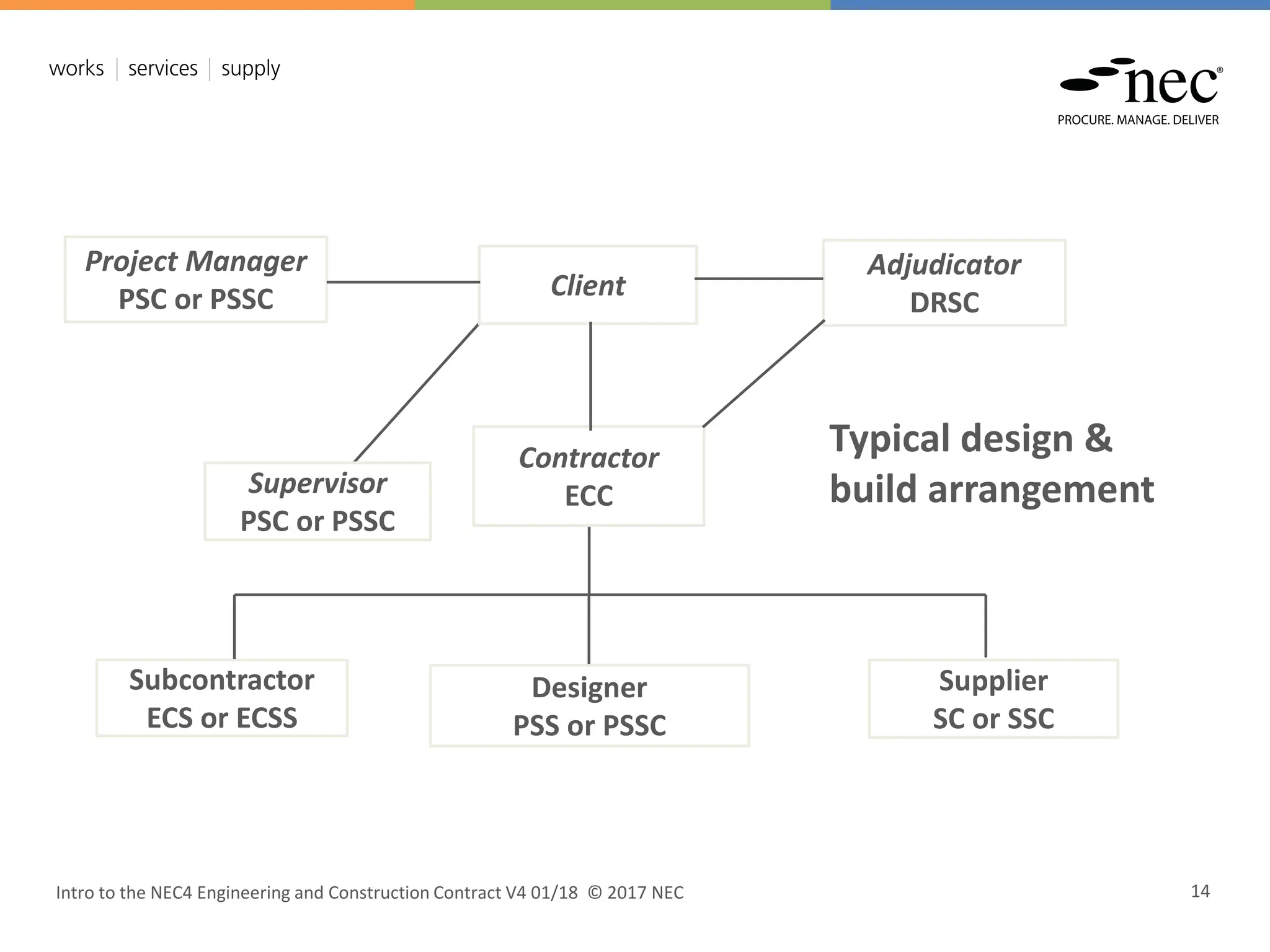

Project Manager
PSC or PSSC
Supplier
SC or SSC
Subcontractor
ECS or ECSS
Designer
PSS or PSSC
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 14
Adjudicator
DRSC
Contractor
ECC
Typical design &
build arrangement
Supervisor
PSC or PSSC
Client

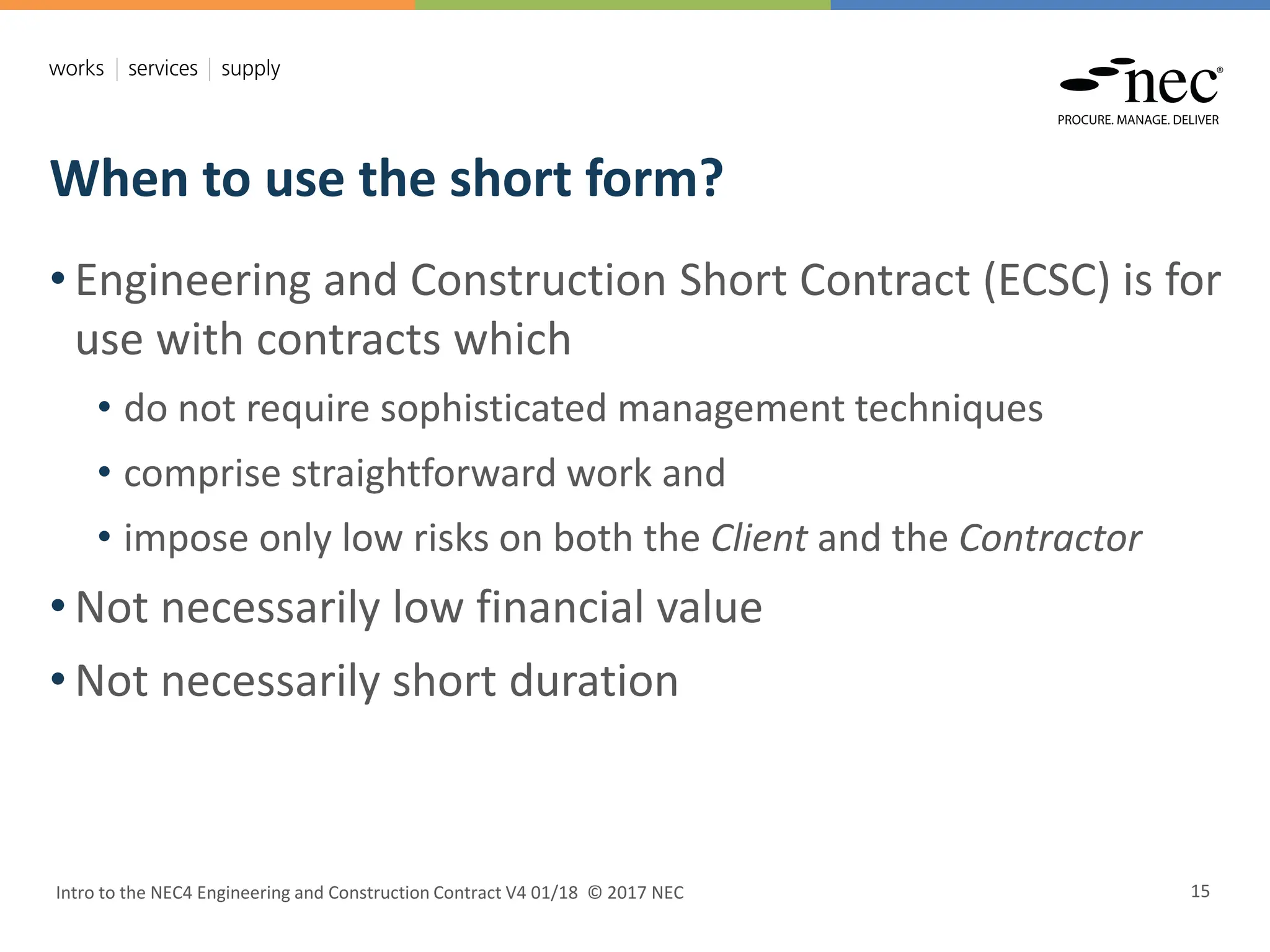

When to use the short form?
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 15
• Engineering and Construction Short Contract (ECSC) is for
use with contracts which
• do not require sophisticated management techniques
• comprise straightforward work and
• impose only low risks on both the Client and the Contractor
• Not necessarily low financial value
• Not necessarily short duration

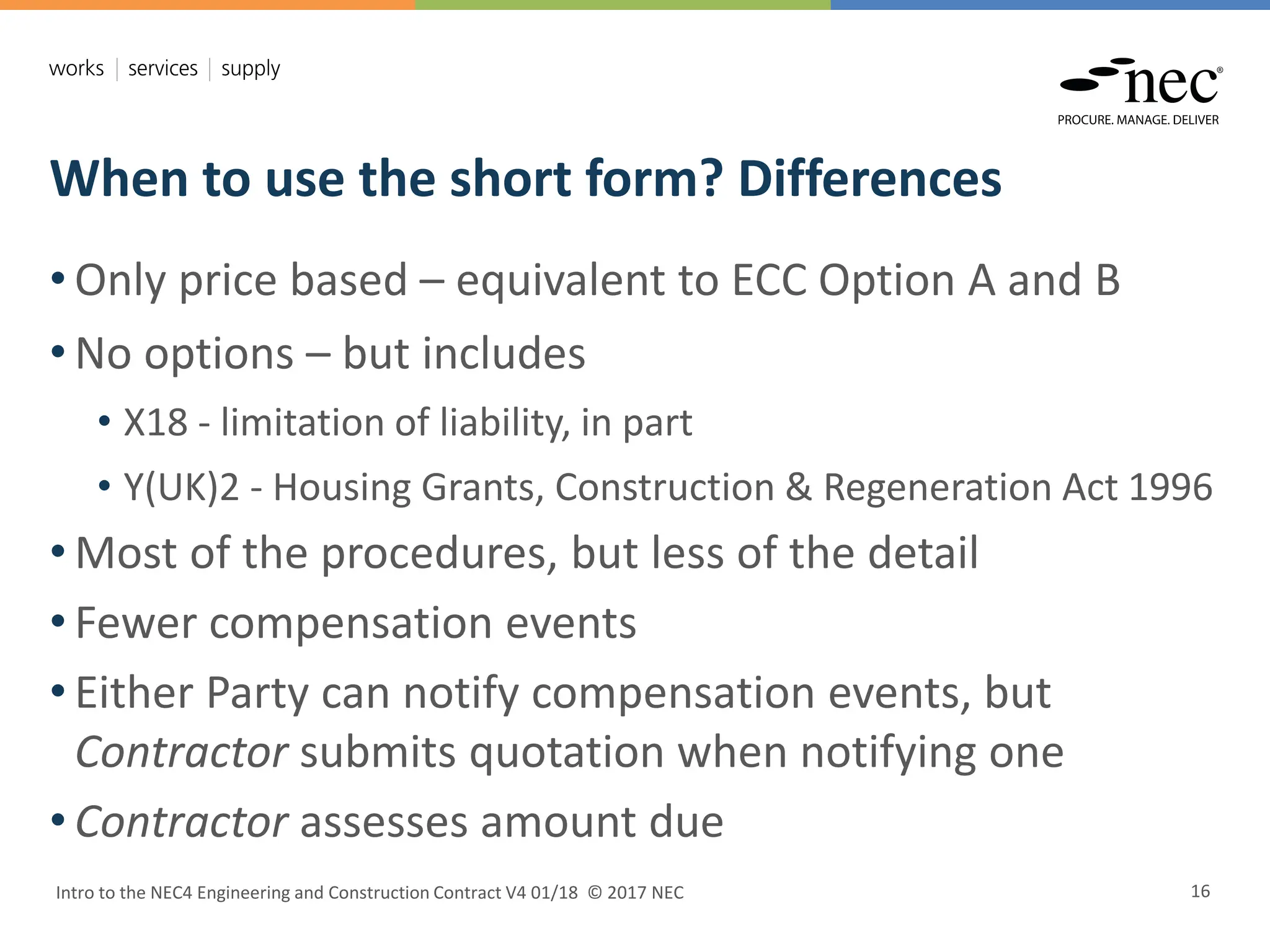

When to use the short form? Differences
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 16
• Only price based – equivalent to ECC Option A and B
• No options – but includes
• X18 - limitation of liability, in part
• Y(UK)2 - Housing Grants, Construction & Regeneration Act 1996
• Most of the procedures, but less of the detail
• Fewer compensation events
• Either Party can notify compensation events, but
Contractor submits quotation when notifying one
• Contractor assesses amount due

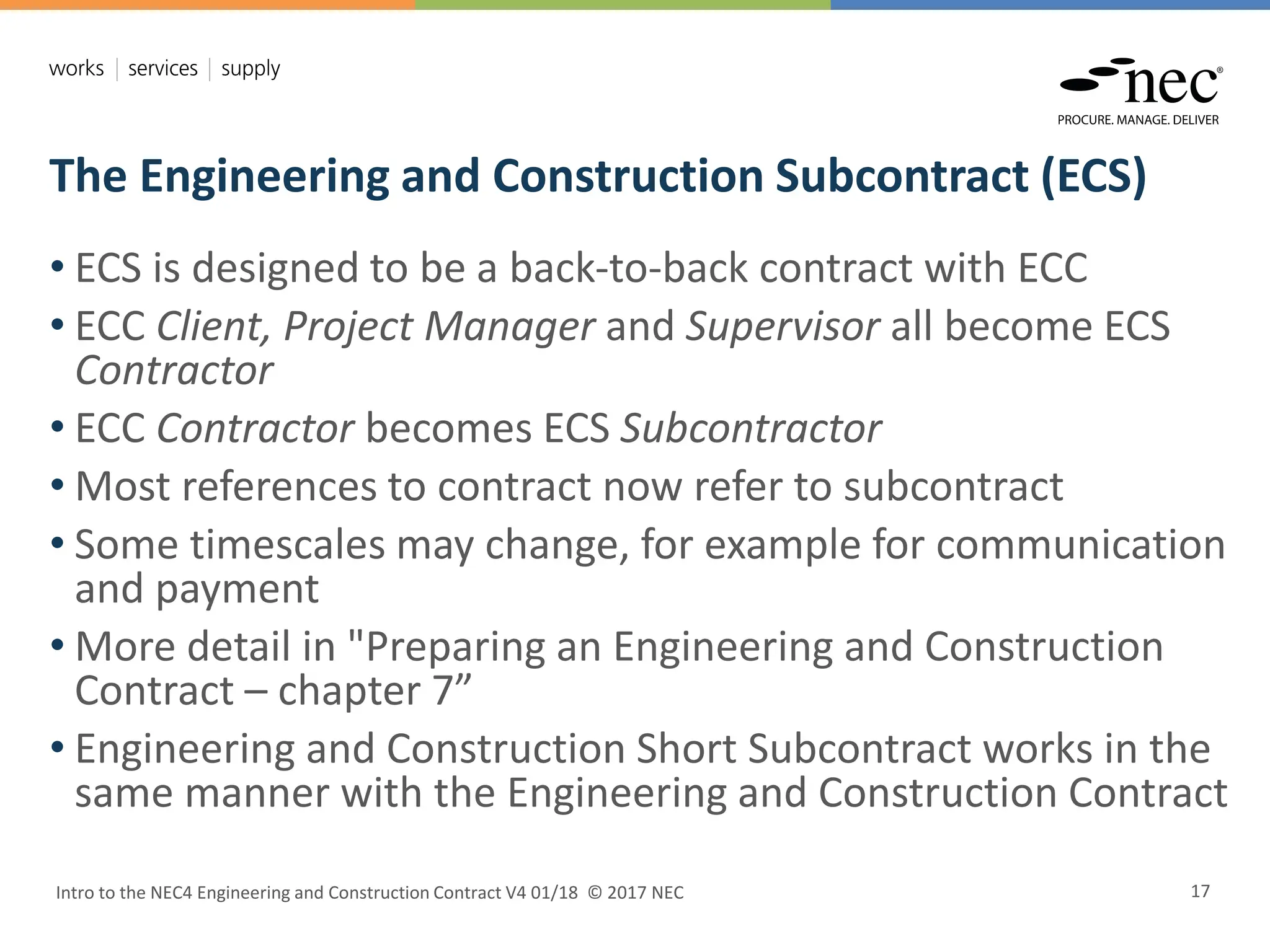

The Engineering and Construction Subcontract (ECS)
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 17
• ECS is designed to be a back-to-back contract with ECC
• ECC Client, Project Manager and Supervisor all become ECS
Contractor
• ECC Contractor becomes ECS Subcontractor
• Most references to contract now refer to subcontract
• Some timescales may change, for example for communication
and payment
• More detail in "Preparing an Engineering and Construction
Contract – chapter 7”
• Engineering and Construction Short Subcontract works in the
same manner with the Engineering and Construction Contract

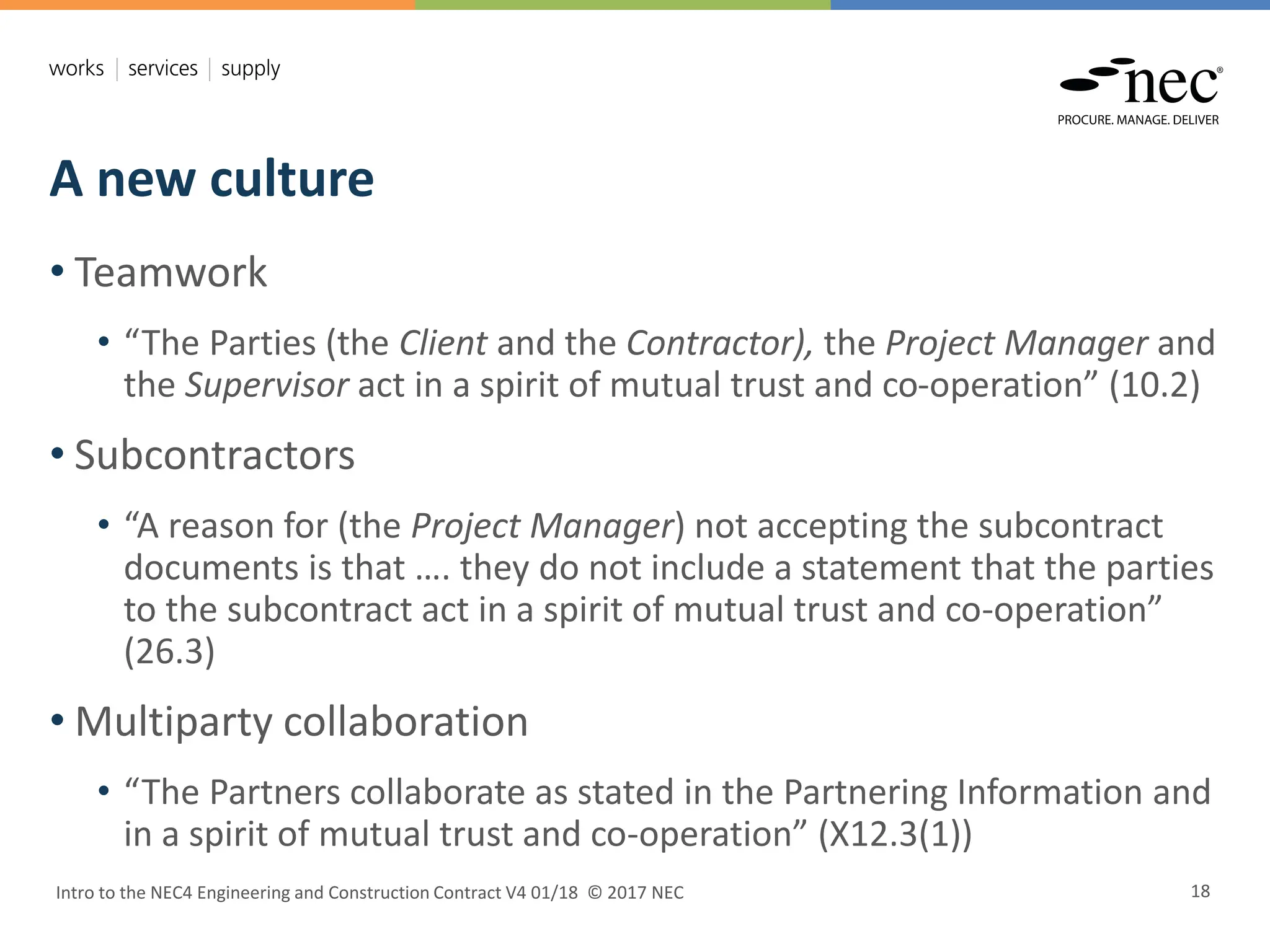

A new culture
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 18
• Teamwork
• “The Parties (the Client and the Contractor), the Project Manager and
the Supervisor act in a spirit of mutual trust and co-operation” (10.2)
• Subcontractors
• “A reason for (the Project Manager) not accepting the subcontract
documents is that …. they do not include a statement that the parties
to the subcontract act in a spirit of mutual trust and co-operation”
(26.3)
• Multiparty collaboration
• “The Partners collaborate as stated in the Partnering Information and
in a spirit of mutual trust and co-operation” (X12.3(1))

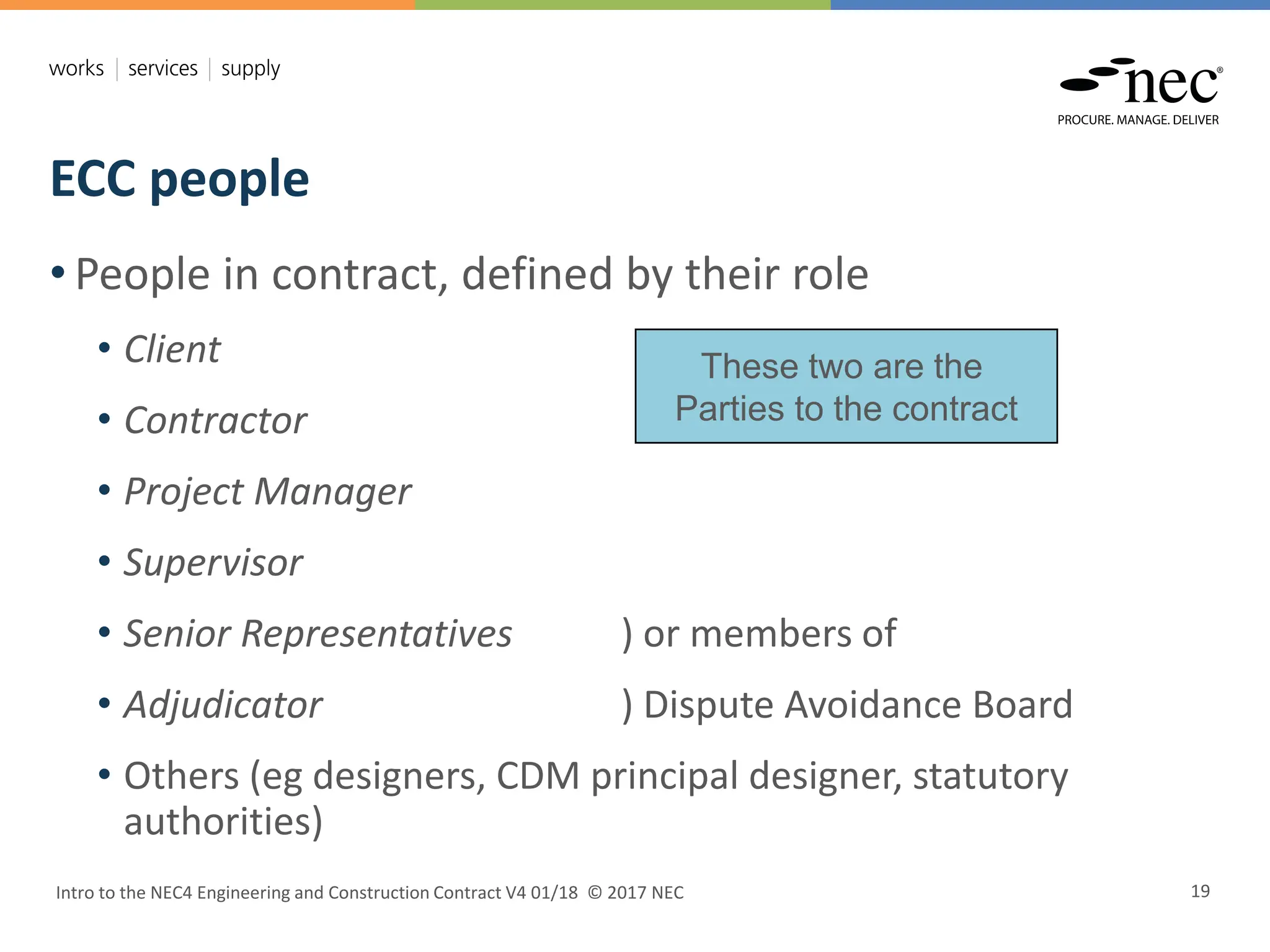

ECC people
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 19
• People in contract, defined by their role
• Client
• Contractor
• Project Manager
• Supervisor
• Senior Representatives ) or members of
• Adjudicator ) Dispute Avoidance Board
• Others (eg designers, CDM principal designer, statutory
authorities)
These two are the
Parties to the contract
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 20
Session 2 – Using the ECC : the contract strategy

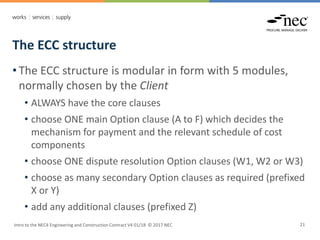

The ECC structure

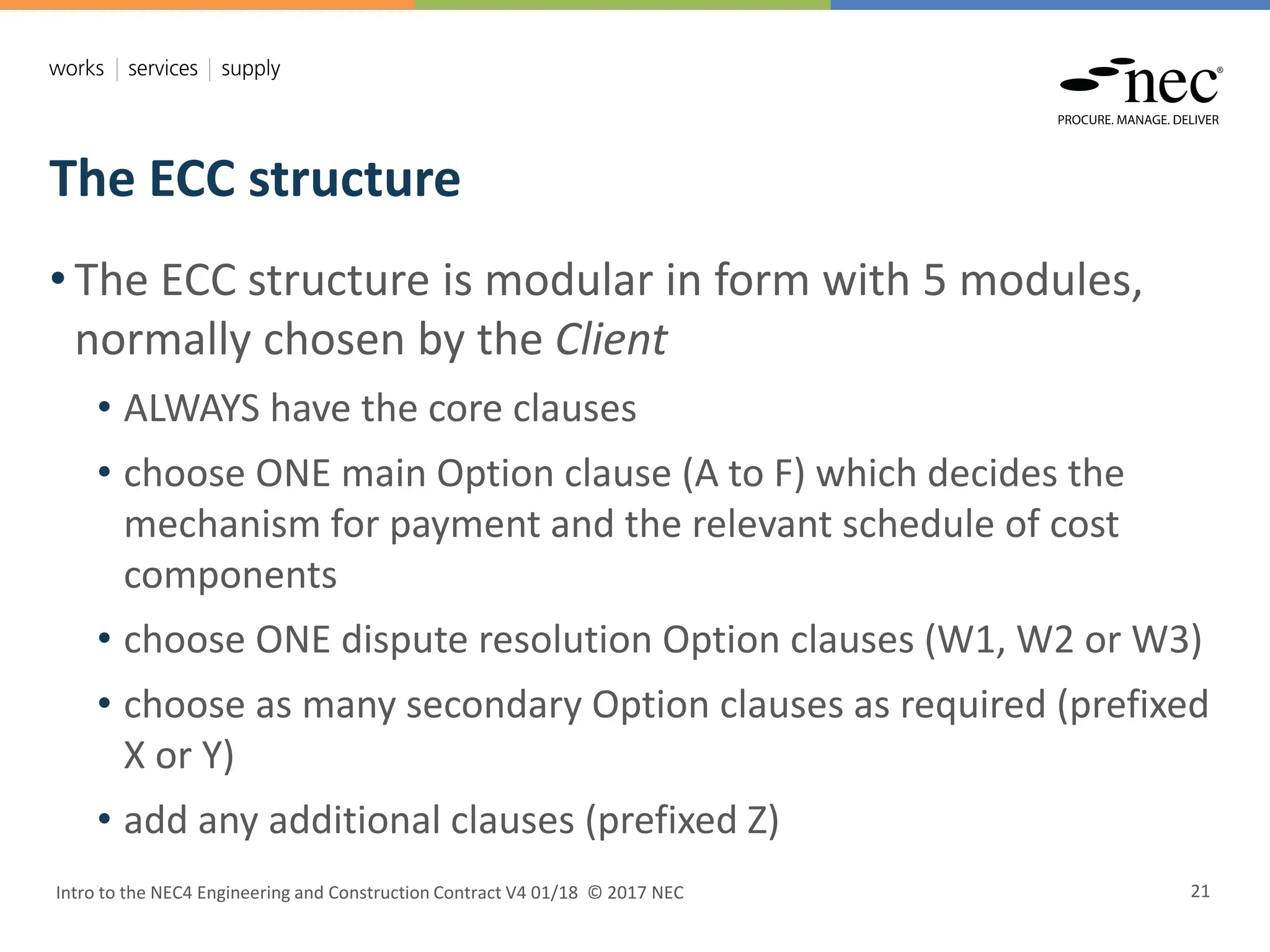

Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 21
• The ECC structure is modular in form with 5 modules,
normally chosen by the Client
• ALWAYS have the core clauses
• choose ONE main Option clause (A to F) which decides the
mechanism for payment and the relevant schedule of cost
components
• choose ONE dispute resolution Option clauses (W1, W2 or W3)
• choose as many secondary Option clauses as required (prefixed
X or Y)
• add any additional clauses (prefixed Z)

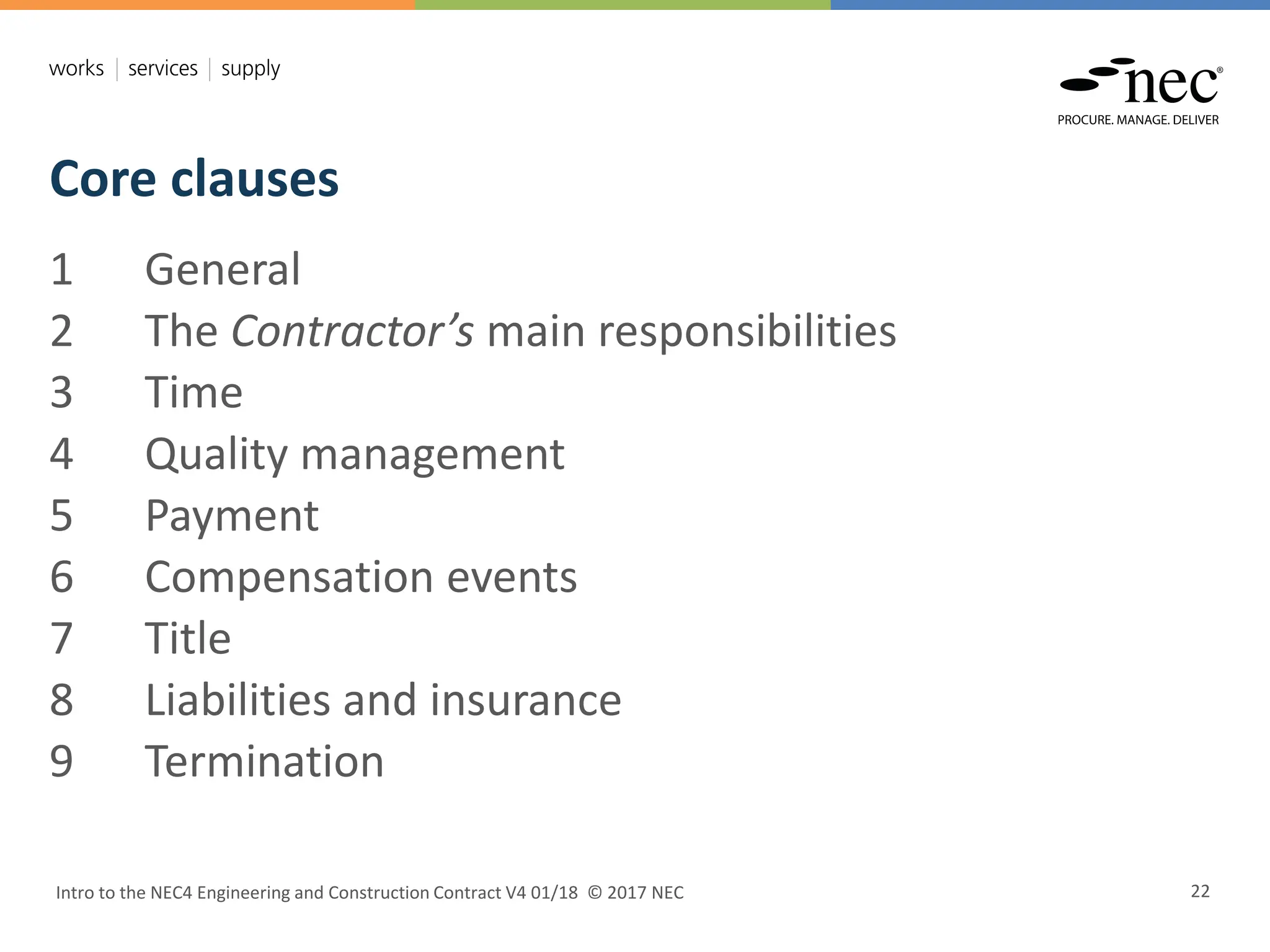

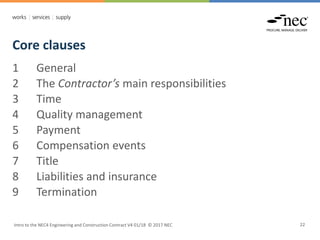

Core clauses
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 22
1 General
2 The Contractor’s main responsibilities
3 Time
4 Quality management
5 Payment
6 Compensation events
7 Title
8 Liabilities and insurance
9 Termination

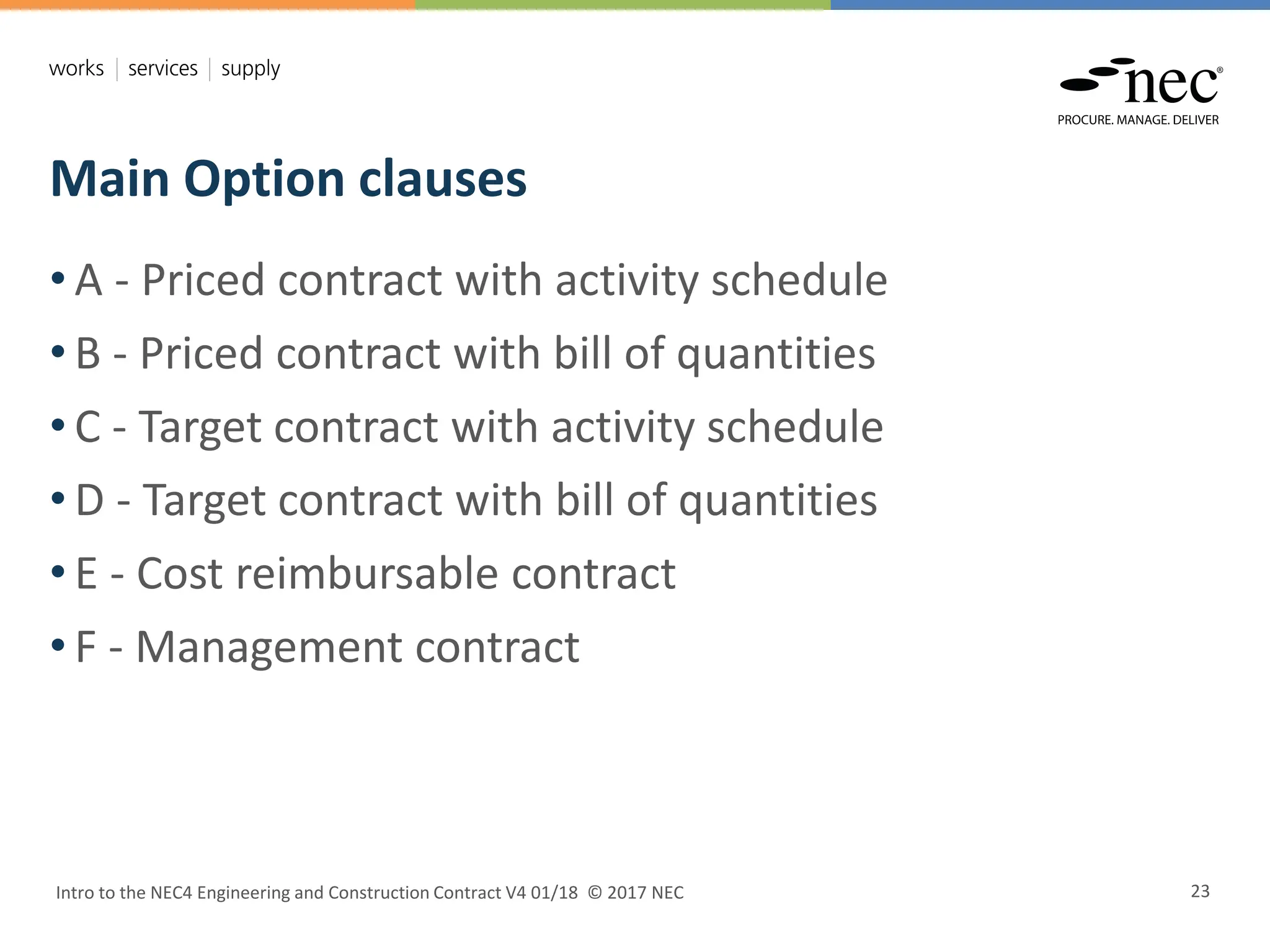

Main Option clauses
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 23
• A - Priced contract with activity schedule
• B - Priced contract with bill of quantities
• C - Target contract with activity schedule
• D - Target contract with bill of quantities
• E - Cost reimbursable contract
• F - Management contract

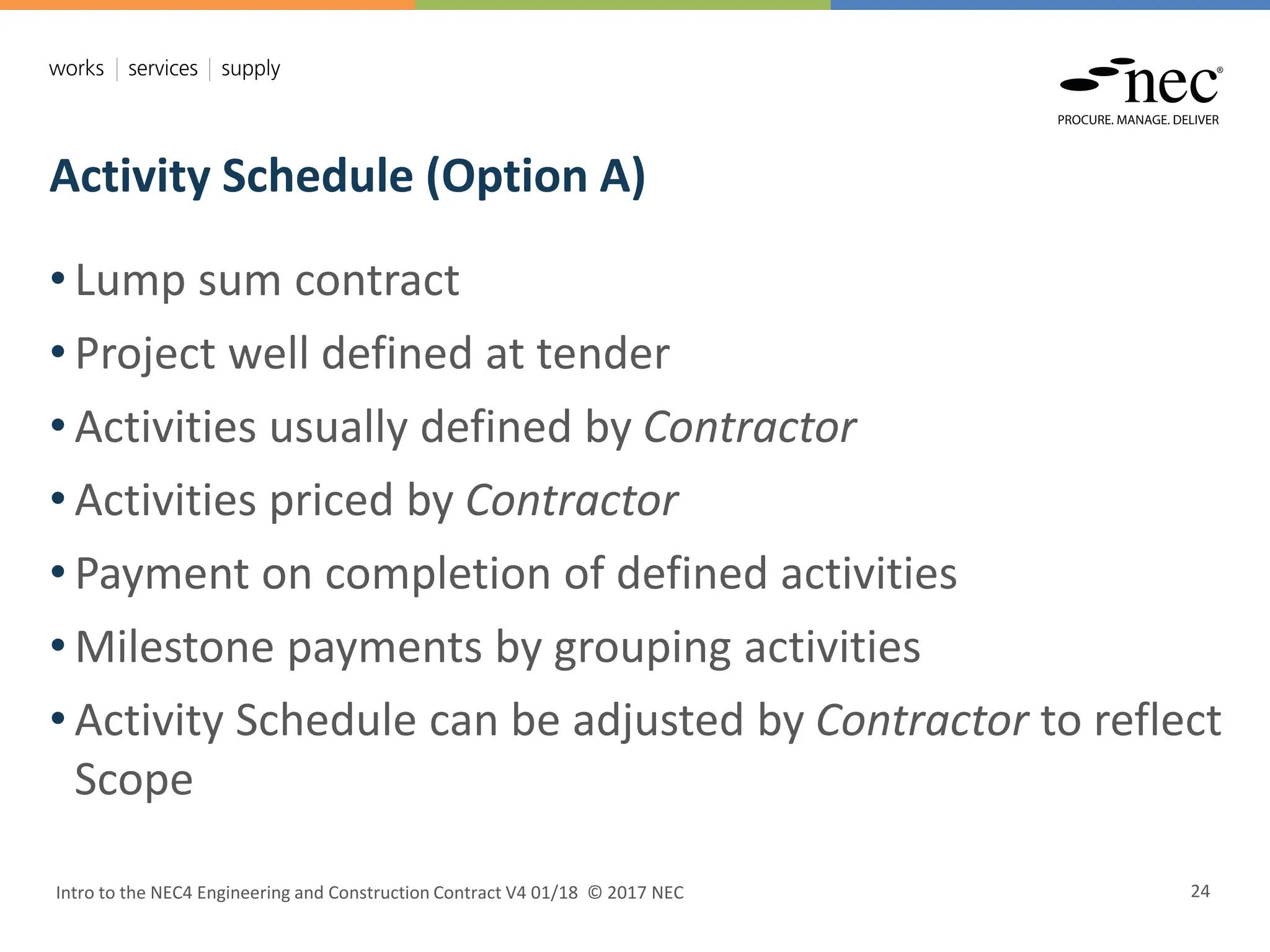

Activity Schedule (Option A)
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 24
• Lump sum contract
• Project well defined at tender
• Activities usually defined by Contractor
• Activities priced by Contractor
• Payment on completion of defined activities
• Milestone payments by grouping activities
• Activity Schedule can be adjusted by Contractor to reflect
Scope

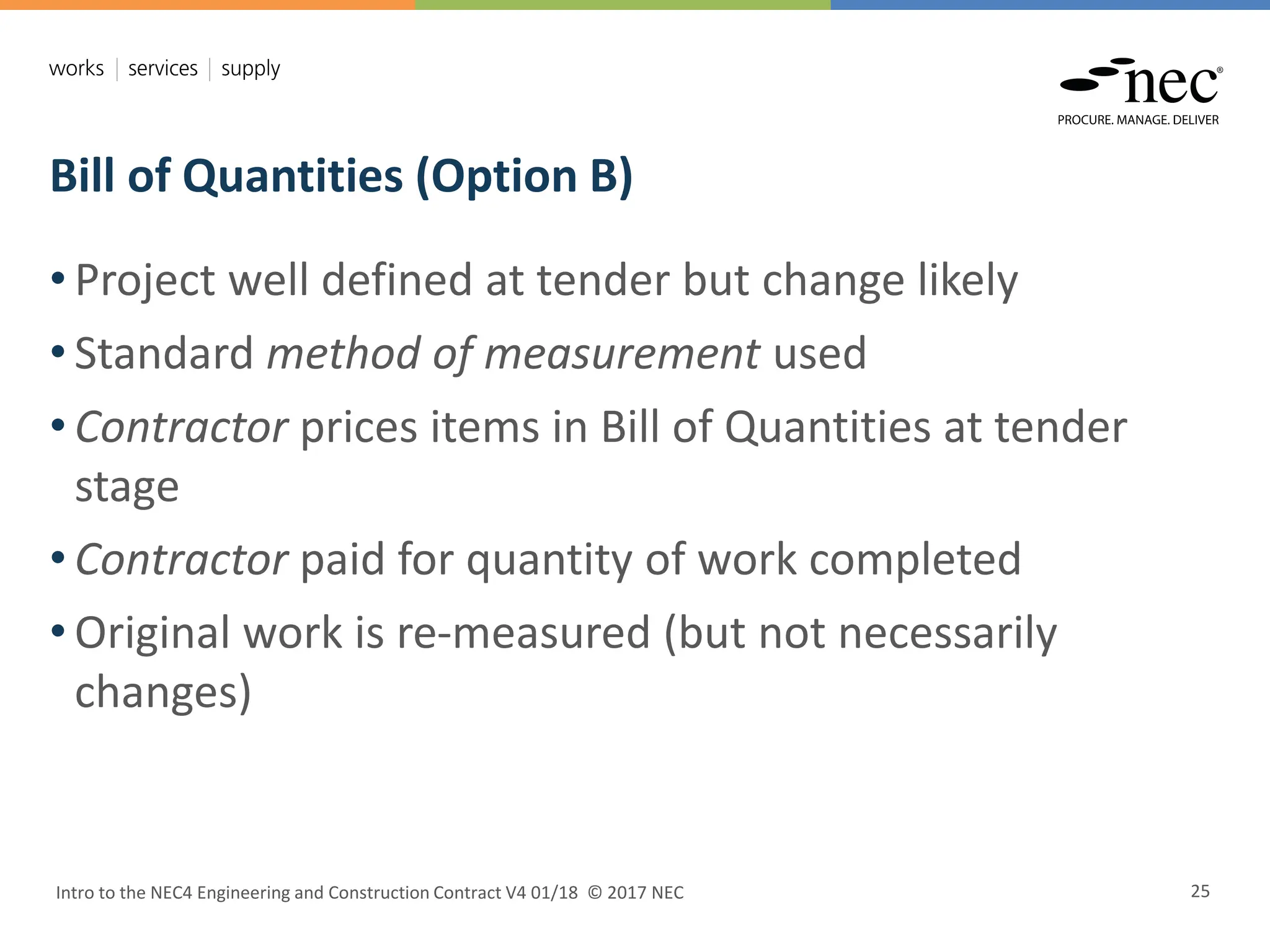

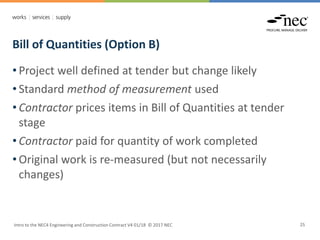

Bill of Quantities (Option B)
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 25
• Project well defined at tender but change likely
• Standard method of measurement used
• Contractor prices items in Bill of Quantities at tender
stage
• Contractor paid for quantity of work completed
• Original work is re-measured (but not necessarily
changes)

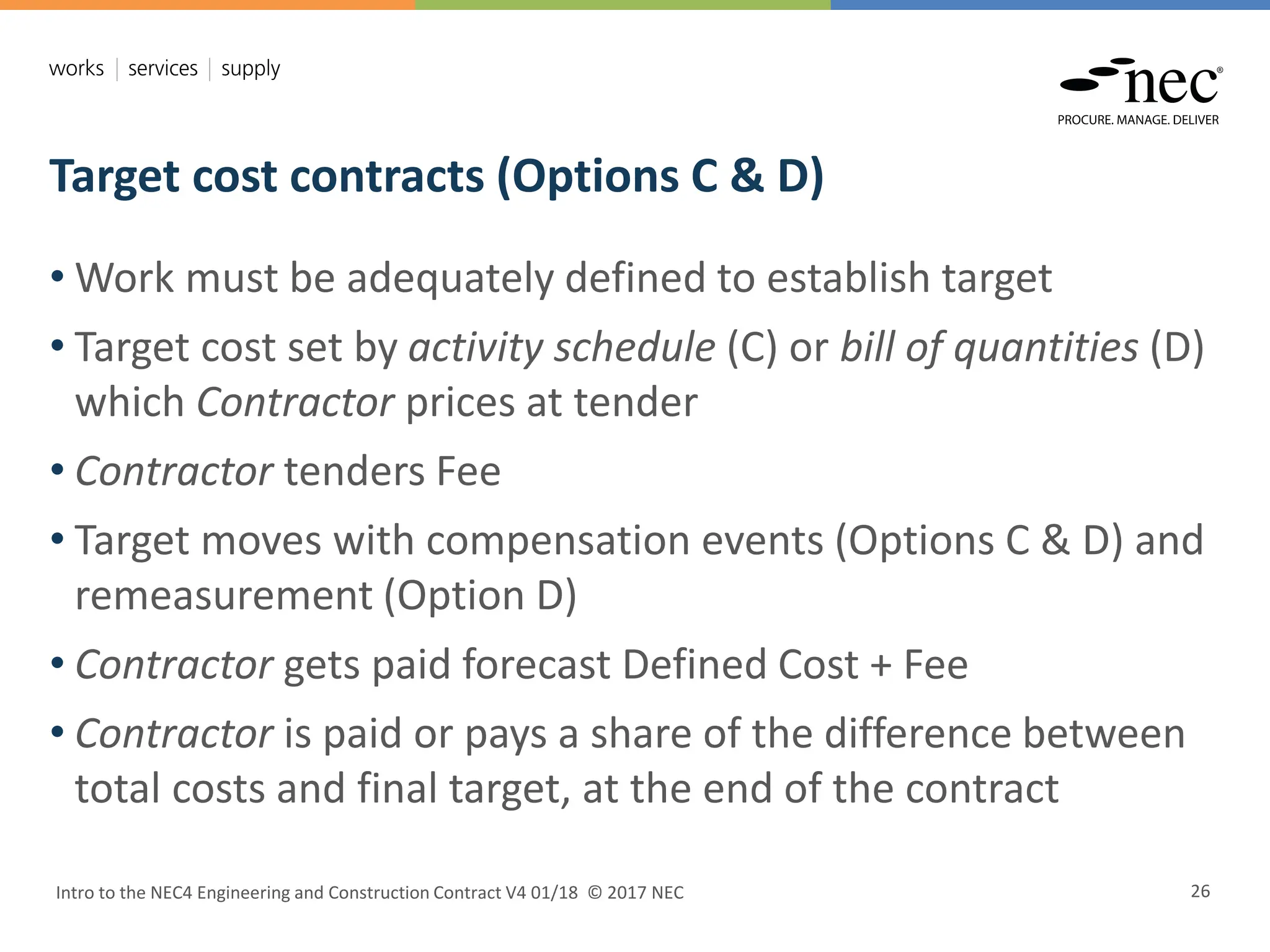

Target cost contracts (Options C & D)
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 26
• Work must be adequately defined to establish target
• Target cost set by activity schedule (C) or bill of quantities (D)
which Contractor prices at tender
• Contractor tenders Fee
• Target moves with compensation events (Options C & D) and
remeasurement (Option D)
• Contractor gets paid forecast Defined Cost + Fee
• Contractor is paid or pays a share of the difference between
total costs and final target, at the end of the contract

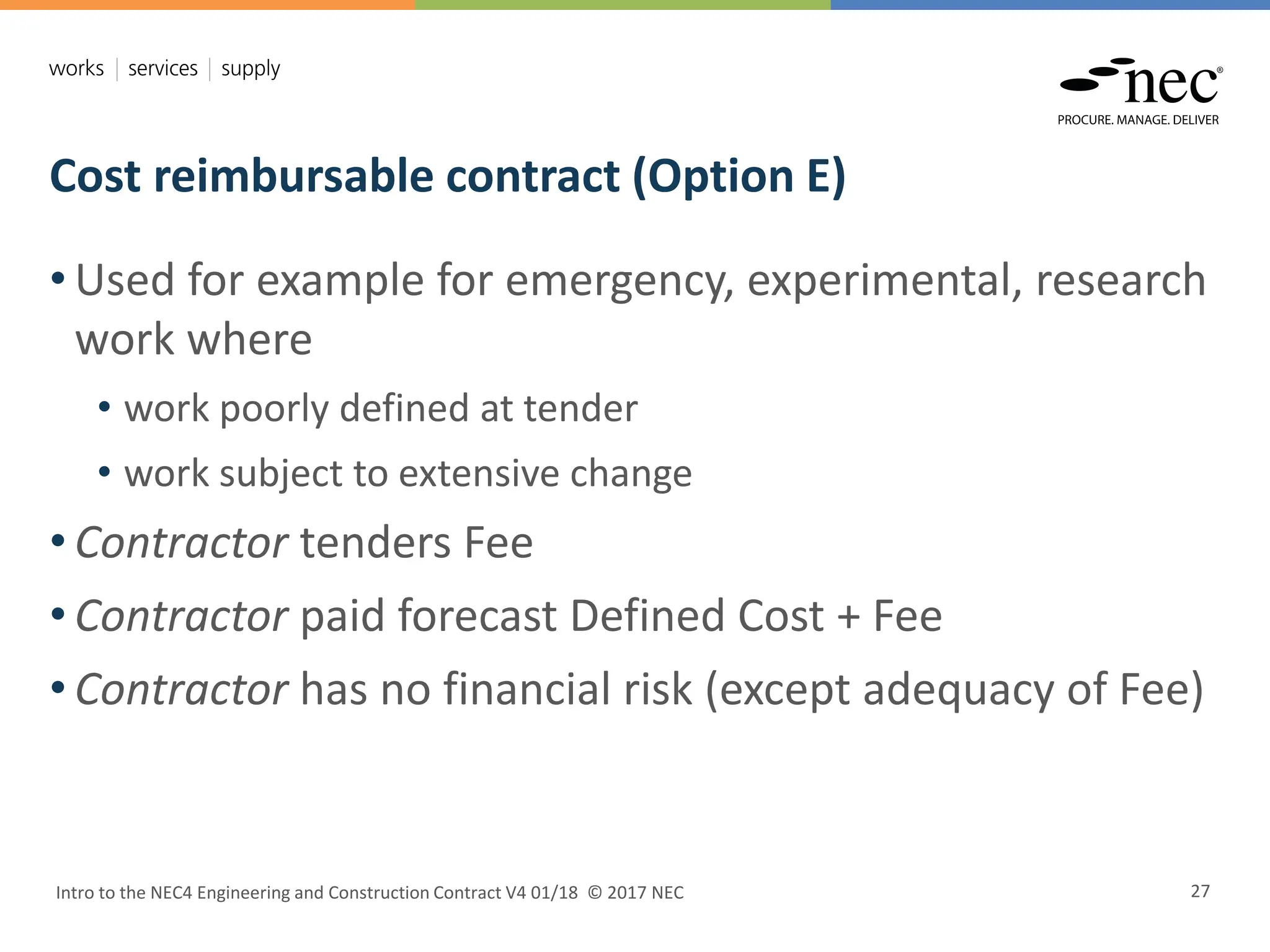

Cost reimbursable contract (Option E)
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 27
• Used for example for emergency, experimental, research
work where
• work poorly defined at tender
• work subject to extensive change
• Contractor tenders Fee
• Contractor paid forecast Defined Cost + Fee
• Contractor has no financial risk (except adequacy of Fee)

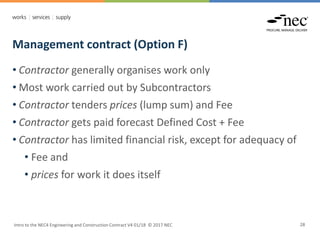

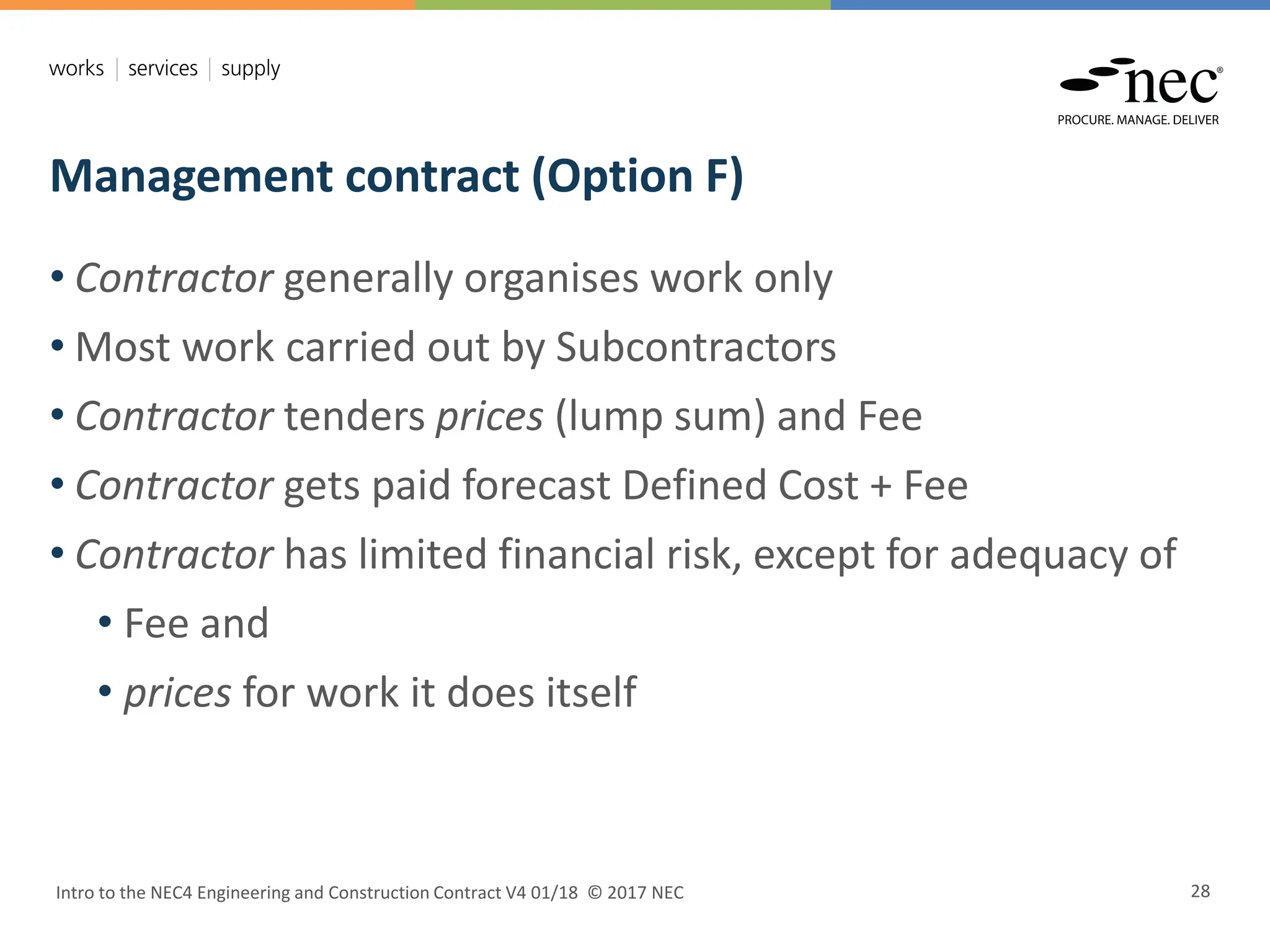

Management contract (Option F)
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 28
• Contractor generally organises work only
• Most work carried out by Subcontractors
• Contractor tenders prices (lump sum) and Fee
• Contractor gets paid forecast Defined Cost + Fee
• Contractor has limited financial risk, except for adequacy of
• Fee and
• prices for work it does itself
A
Contractor
Client
B
F
E
D
C
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 29

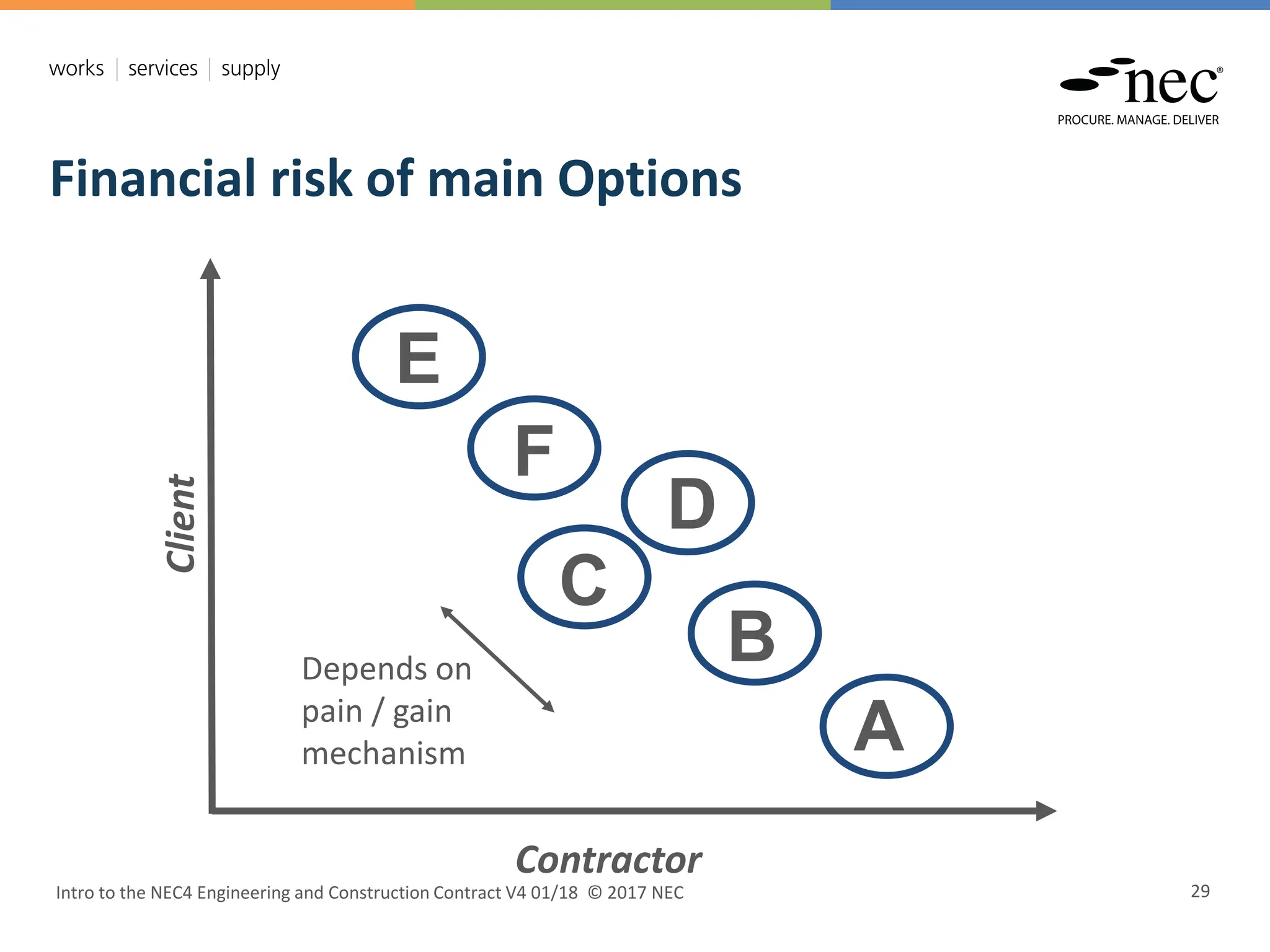

Financial risk of main Options
Depends on
pain / gain
mechanism

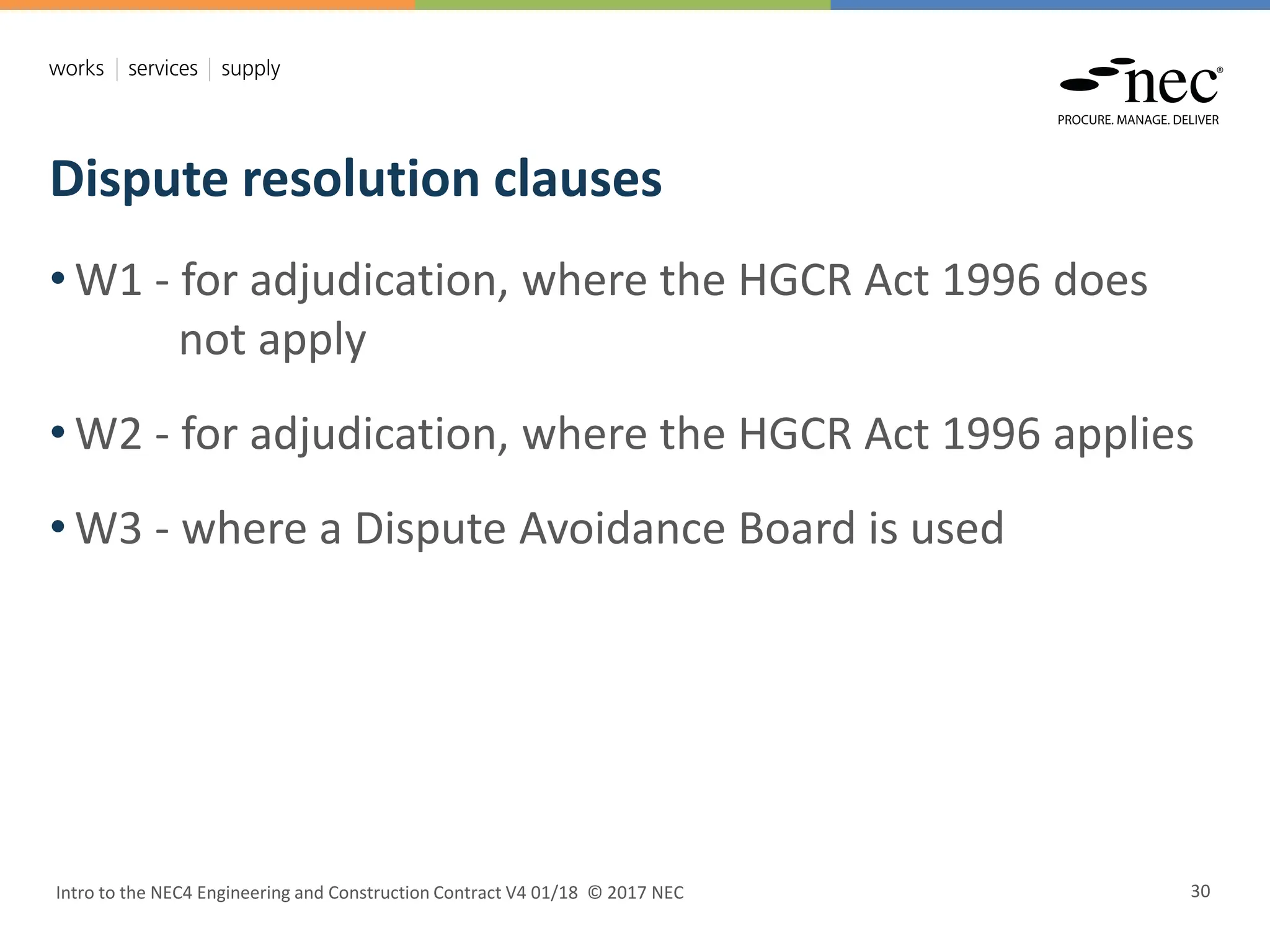

Dispute resolution clauses
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 30
• W1 - for adjudication, where the HGCR Act 1996 does
not apply
• W2 - for adjudication, where the HGCR Act 1996 applies
• W3 - where a Dispute Avoidance Board is used

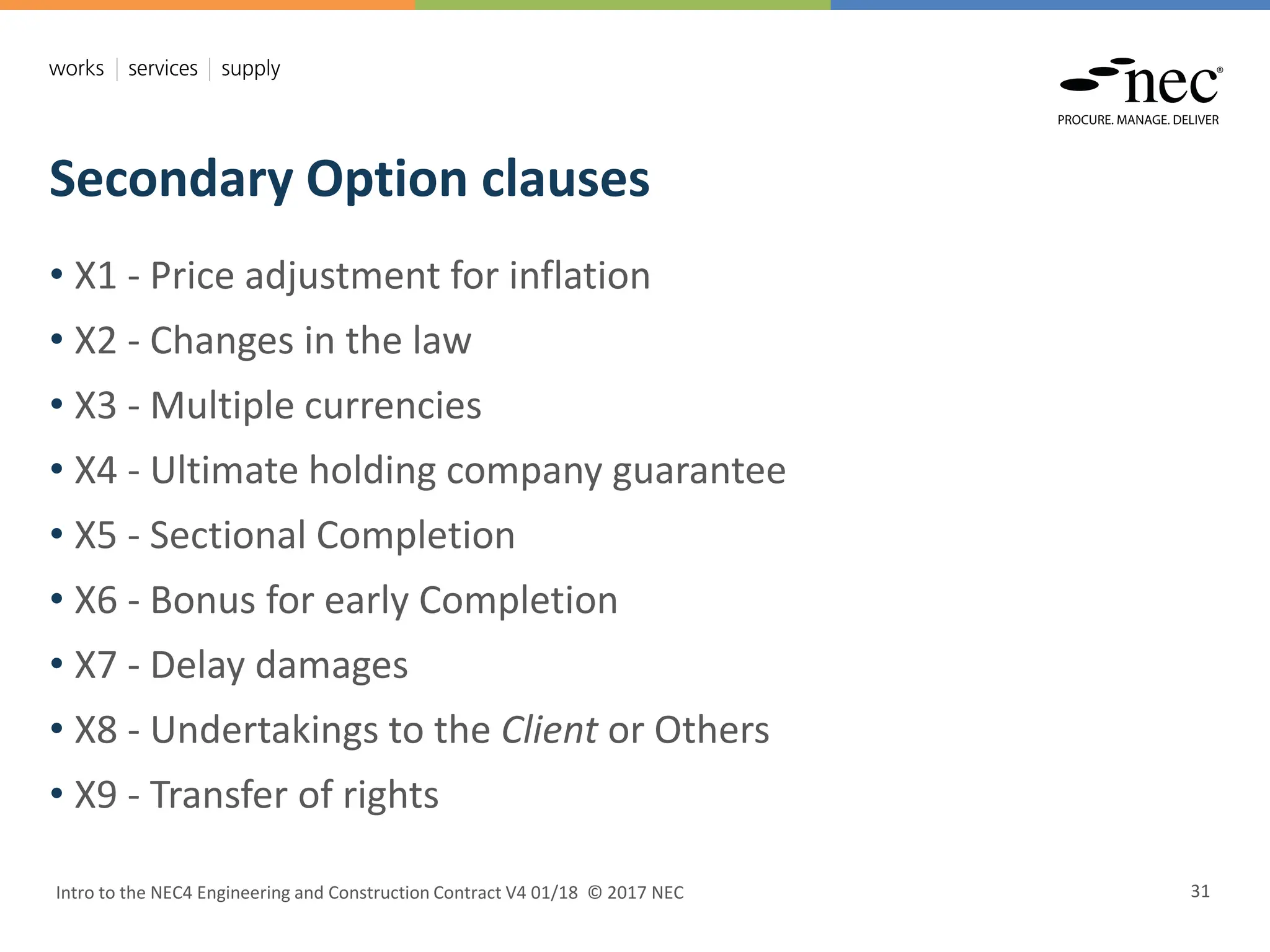

Secondary Option clauses
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 31
• X1 - Price adjustment for inflation
• X2 - Changes in the law
• X3 - Multiple currencies
• X4 - Ultimate holding company guarantee
• X5 - Sectional Completion
• X6 - Bonus for early Completion
• X7 - Delay damages
• X8 - Undertakings to the Client or Others
• X9 - Transfer of rights

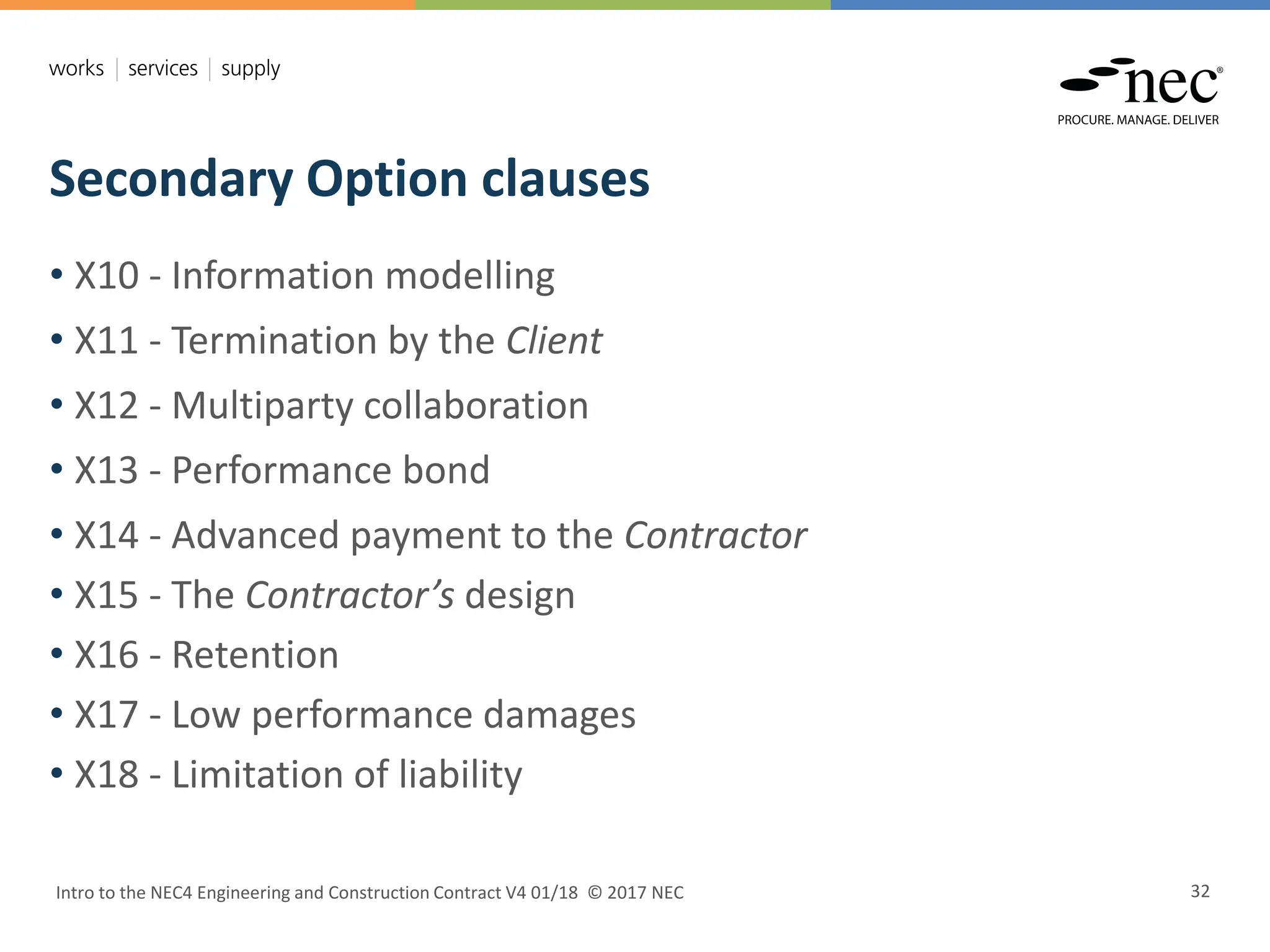

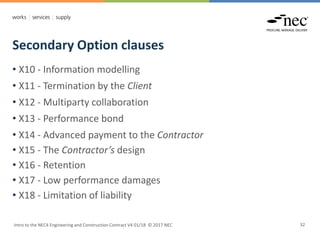

Secondary Option clauses
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 32
• X10 - Information modelling
• X11 - Termination by the Client
• X12 - Multiparty collaboration
• X13 - Performance bond
• X14 - Advanced payment to the Contractor
• X15 - The Contractor’s design
• X16 - Retention
• X17 - Low performance damages
• X18 - Limitation of liability
Secondary Option clauses
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 33
• X20 - Key Performance Indicators
• X21 - Whole life cost
• X22 - Early Contractor involvement
• Y(UK)1 - Project Bank Account
• Y(UK)2 - The Housing Grants, Construction and Regeneration Act
1996
• Y(UK)3 - The Contracts (Rights of Third Parties) Act 1999
• Z - Additional conditions of contract

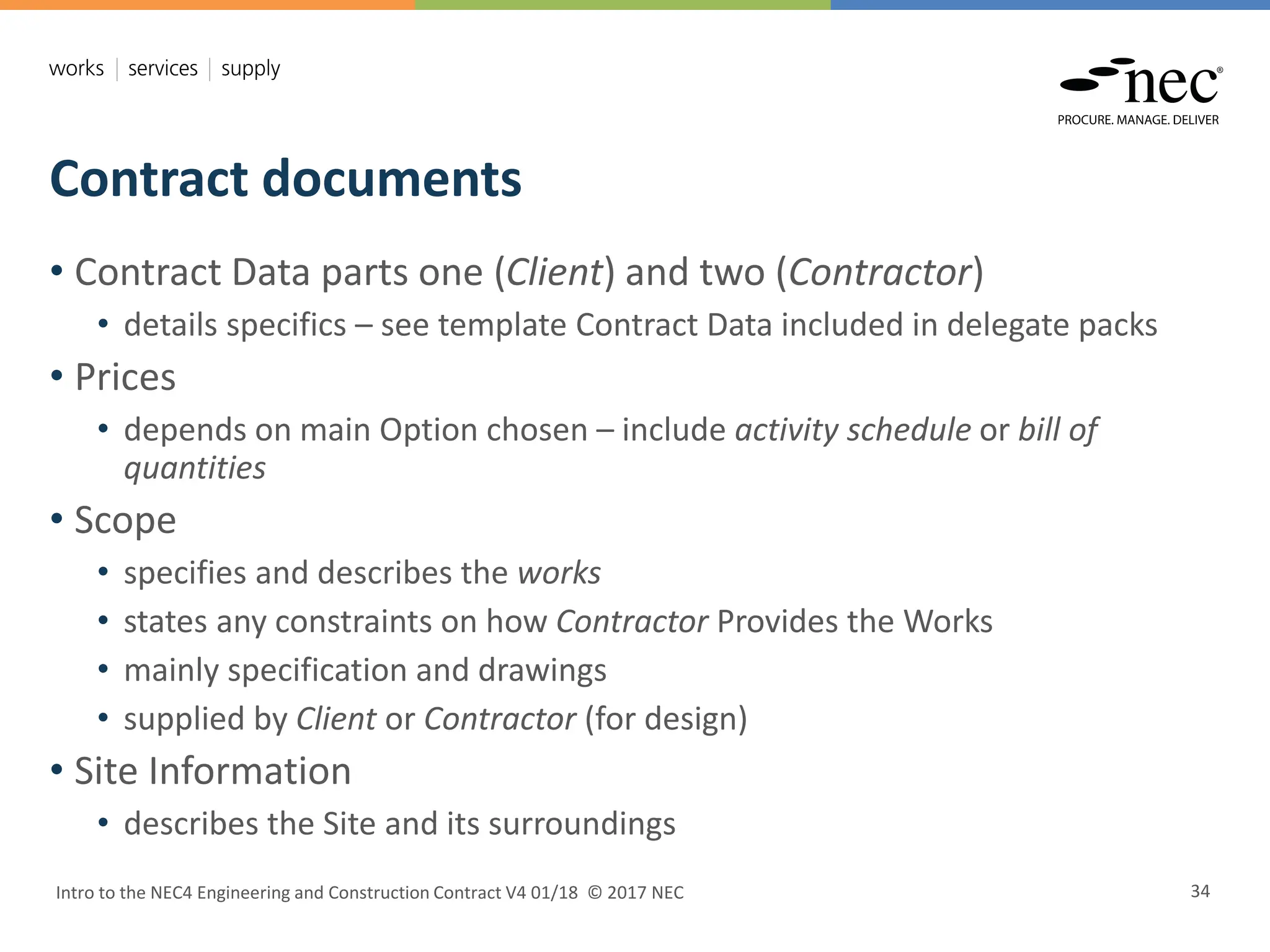

Contract documents
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 34
• Contract Data parts one (Client) and two (Contractor)
• details specifics – see template Contract Data included in delegate packs
• Prices
• depends on main Option chosen – include activity schedule or bill of
quantities
• Scope
• specifies and describes the works
• states any constraints on how Contractor Provides the Works
• mainly specification and drawings
• supplied by Client or Contractor (for design)
• Site Information
• describes the Site and its surroundings
Other documents
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 35
• With Contract Data
• if Option X12 is chosen - Partnering Information
• if Option X20 is chosen - incentive schedule
• In Scope
• if Option X4 is chosen - ultimate holding company guarantee
• if Option X8 is chosen - undertakings to the Client or Others
• if Option X13 is used - performance bond
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 36
Session 3 – Managing the contract :
the ECC processes
Sections
1-9
1
2
3
5
6
4
9
8
7
Session 3.1 – General provisions
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 37
• Actions
• Identified and defined terms
• Communications
• Project Manager and Supervisor
• Early warning
• Contractor’s proposals
1
1

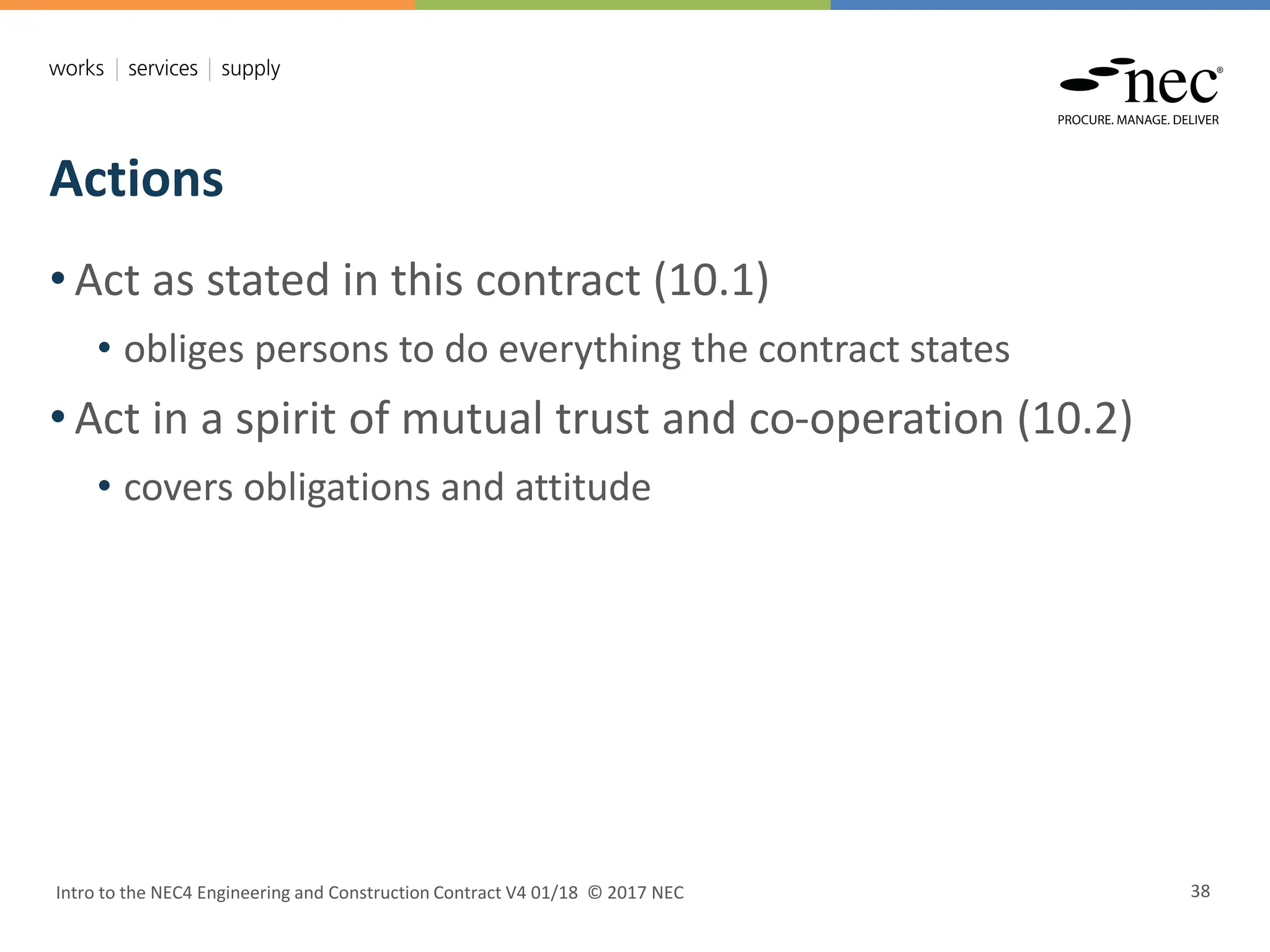

Actions
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 38
• Act as stated in this contract (10.1)
• obliges persons to do everything the contract states
• Act in a spirit of mutual trust and co-operation (10.2)
• covers obligations and attitude
Identified and defined terms
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 39
• Identified terms in Contract Data are in italics
• Defined terms, capitalised and in 11.2
• (1) Accepted Programme
• (2) Completion (certainty of requirements)
• (3) Completion Date
• (5) Corrupt Act
• (6) Defect (two types)
• (7) Defects Certificate
• (8) Early Warning Register
Identified and defined terms
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 40
• (9) Equipment
• (10) Fee (covers all costs not in Defined Cost (52.1))
• (11) Key Date
• (14) Plant and Materials
• (16) Scope
• (17) Site
• (18) Site Information
• (19) Subcontractor
• (20) Working Areas
Communications
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 41
• Must be in a form that can be read, copied and recorded
(13.1)
• see simple examples in delegate packs
• Use of a “communication system” (13.2)
• Replies within period for reply or as in contract (13.3)
• Notifications and certificates to be communicated
separately (13.7)

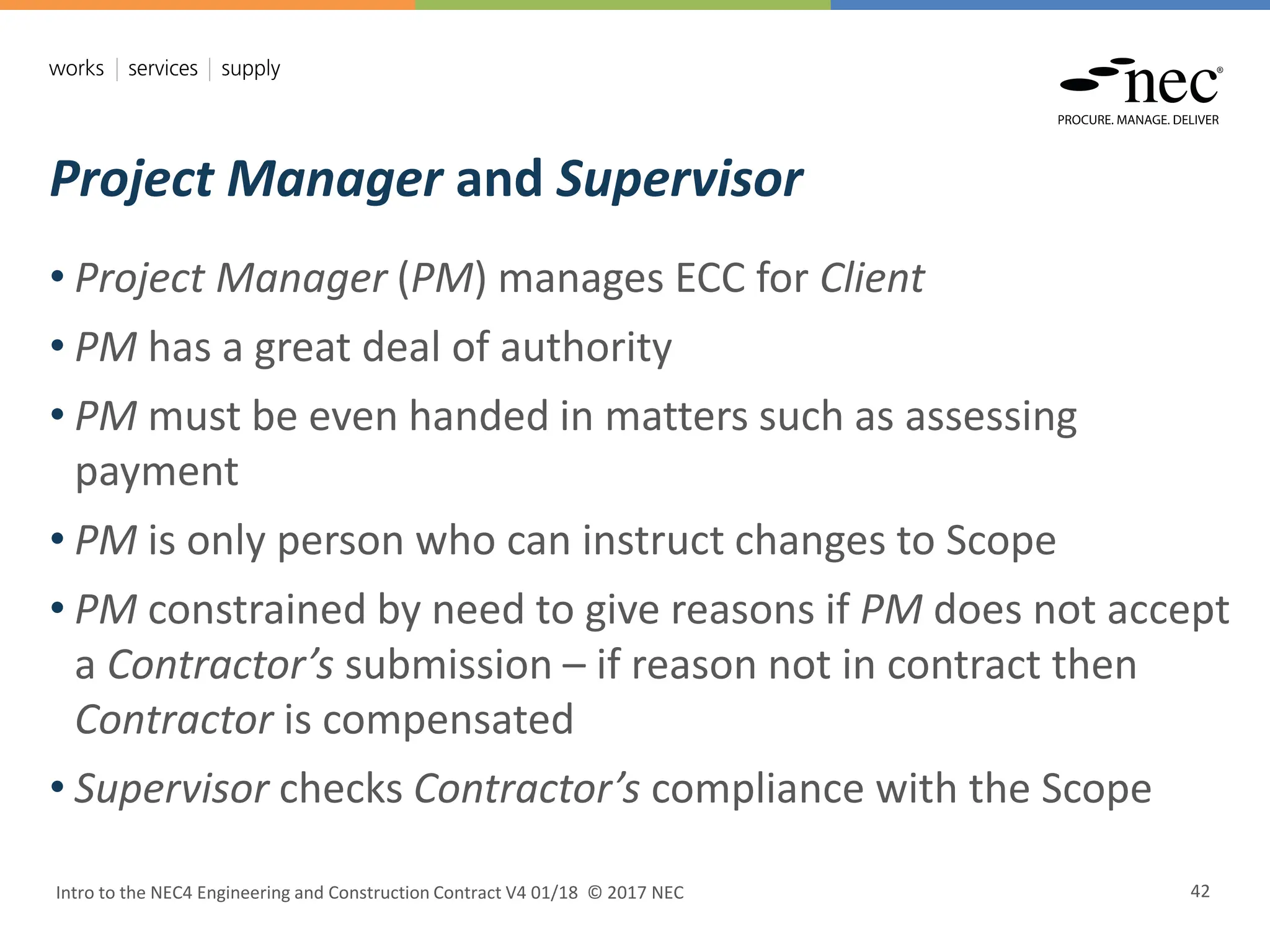

Project Manager and Supervisor
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 42
• Project Manager (PM) manages ECC for Client
• PM has a great deal of authority
• PM must be even handed in matters such as assessing
payment
• PM is only person who can instruct changes to Scope
• PM constrained by need to give reasons if PM does not accept
a Contractor’s submission – if reason not in contract then
Contractor is compensated
• Supervisor checks Contractor’s compliance with the Scope

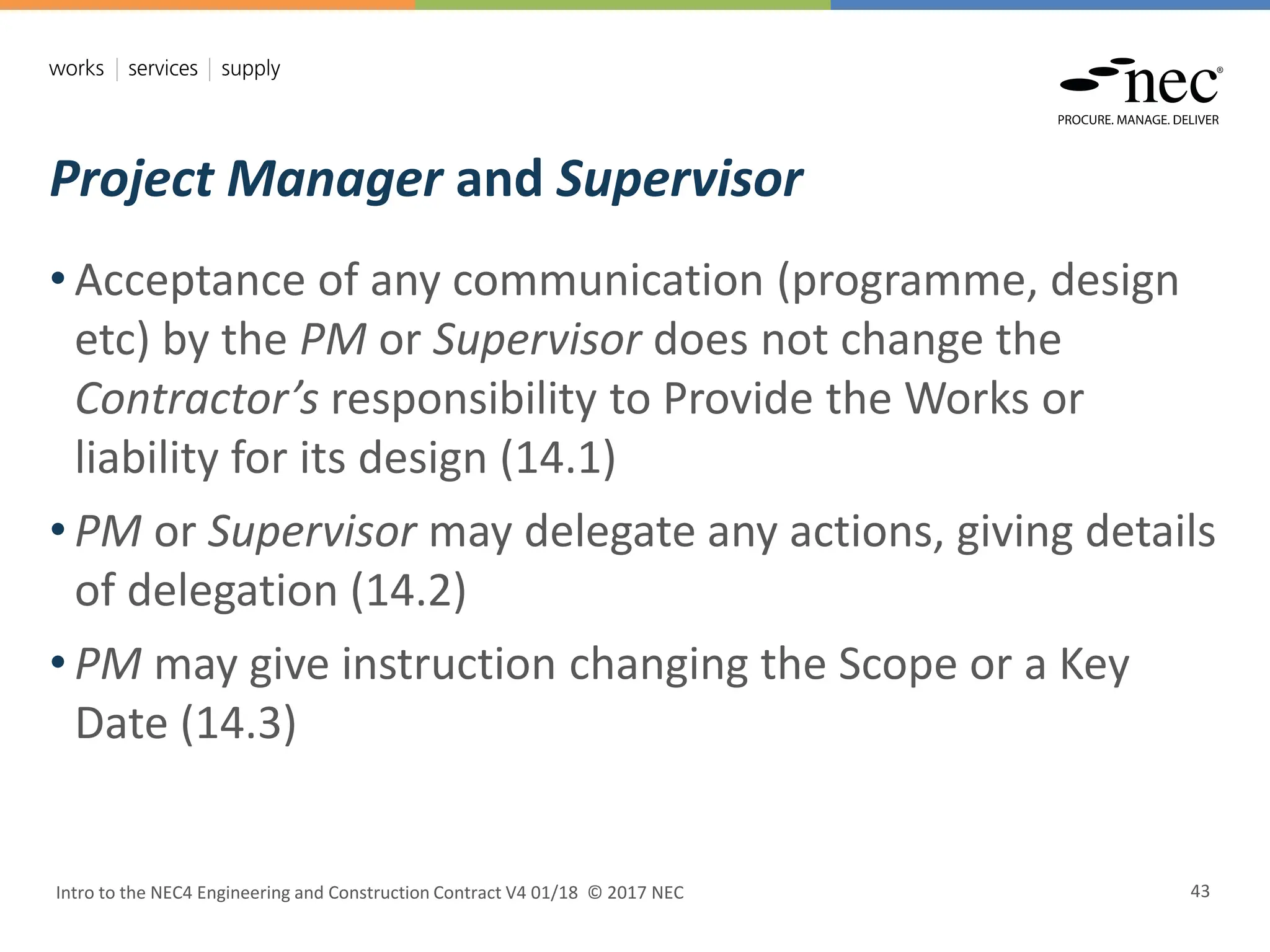

Project Manager and Supervisor
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 43
• Acceptance of any communication (programme, design
etc) by the PM or Supervisor does not change the
Contractor’s responsibility to Provide the Works or
liability for its design (14.1)
• PM or Supervisor may delegate any actions, giving details
of delegation (14.2)
• PM may give instruction changing the Scope or a Key
Date (14.3)
Early warning
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 44
• Contractor and PM have a duty to notify the other as soon as
they are aware of a matter which could
• increase the total of the Prices
• delay Completion
• delay meeting a Key Date or
• impair the performance of the works in use (15.1) or
• adversely affect the creation or use of the Information Model (X10.3)
• PM or Contractor may give an early warning by notifying the
other of any other matter which could increase Contractor’s
total cost
• PM enters early warning matters in Early Warning Register
(15.1)
Early warning
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 45
• PM prepares and issues first Early Warning Register
within one week of starting date (15.2)
• PM instructs first early warning meeting within two
weeks of starting date
• Either party may at any time instruct the other to attend
later early warning meeting
• Further early warning meetings occur
• when instructed by a party and
• no longer than intervals stated in Contract Data
Early warning
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 46
• A Subcontractor attends if attendance will assist (15.2)
• Those attending co-operate in making and considering
proposals to avoid or reduce effects, seeking solutions,
deciding actions, reviewing and perhaps removing
matters from Early Warning Register (15.3)
• PM revises Early Warning Register to record decisions and
issues within one week (15.4)
• Encourages collaboration, innovation and ability to adjust
to circumstances during the contract
Contractor’s proposals
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 47
• Contractor may propose changes to Client’s Scope which
reduces the total of the Prices (16.1)
• If the PM accepts the proposal, the PM issues an
instruction changing the Scope (16.2)
• For Option A and B, the benefit is shared by the value
engineering percentage (63.12) if
• the change is to Client’s Scope and
• the total Defined Cost is reduced by the compensation event
• The PM does not change the Scope as proposed unless it
accepts the quotation
Session 3.2 - Contractor’s main responsibilities
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 48
• Providing the Works
• Contractor’s design
• People
• Working with the Client and Others
• Subcontracting
2
2
Works
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 49
• Providing the Works (20)
• Contractor Provides the Works in accordance with the Scope
Design
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 50
• Contractor’s design (21)
• Contractor designs the parts of the works which the Scope states it is
to design
• default is Client design
• design acceptance before proceeding
• reasons for not accepting design
• Using the design (22)
• Contractor owns its rights (22.1) unless Option X9 adopted
• Design liability
• Contractor may have limited design liability (Option X15)
People
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 51
• The Contractor
• employs each key person stated in Contract Data or
• employs replacement person accepted by PM (24.1)
• Reasons for not accepting (24.1)
• PM may instruct removal of a person (24.2)

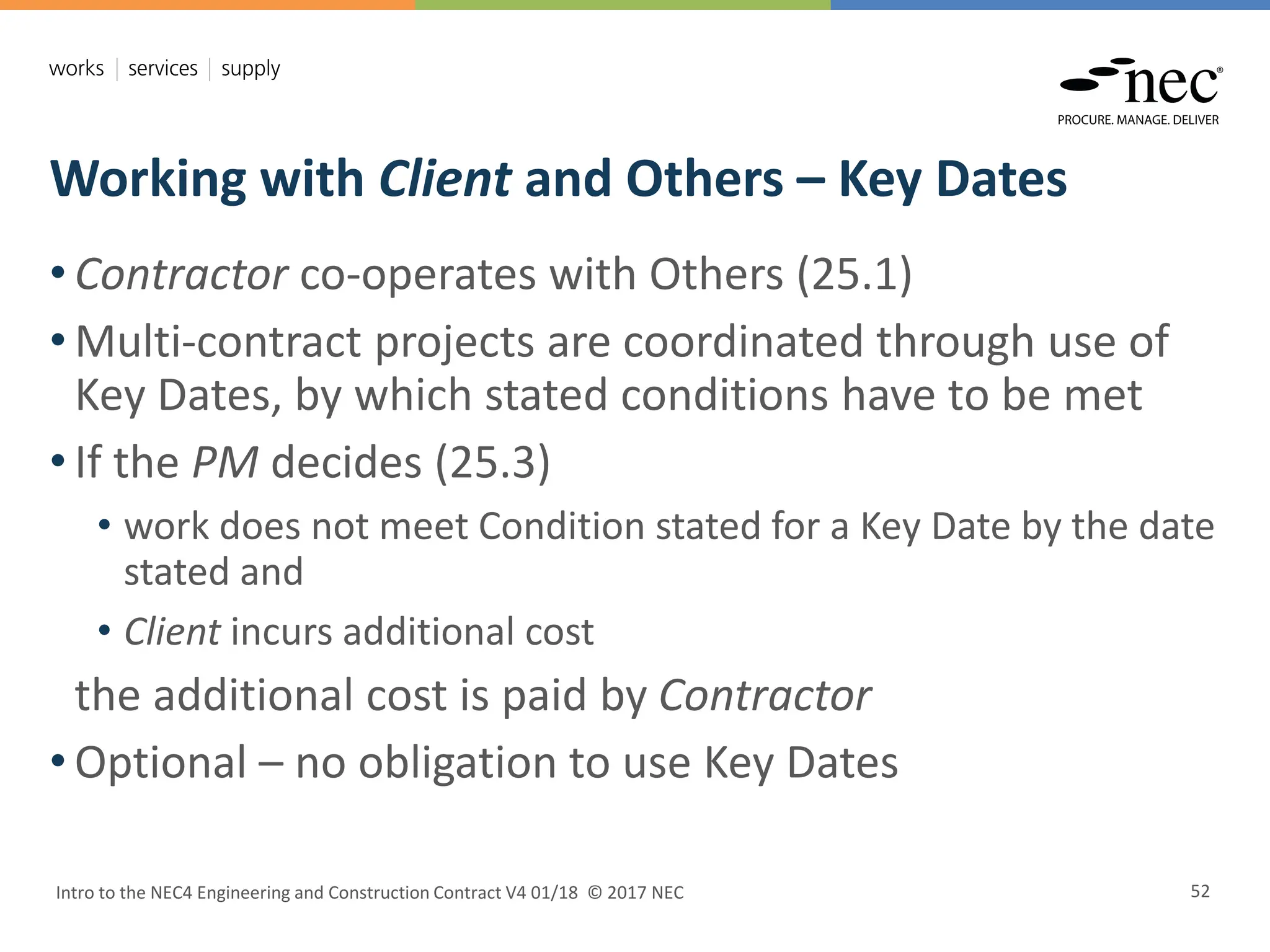

Working with Client and Others – Key Dates
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 52
• Contractor co-operates with Others (25.1)
• Multi-contract projects are coordinated through use of
Key Dates, by which stated conditions have to be met
• If the PM decides (25.3)
• work does not meet Condition stated for a Key Date by the date
stated and
• Client incurs additional cost
the additional cost is paid by Contractor
• Optional – no obligation to use Key Dates
Subcontracting
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 53
• If subcontracts, Contractor still responsible for Providing
the Works (26.1)
• Contractor submits for all Options
• name of each proposed Subcontractor to PM for acceptance
(26.2)
• proposed subcontract documents except pricing information
unless
• NEC contract is proposed, unamended except for changes in main
contract, or
• PM agrees no submission required (26.3)
• Contractor additionally submits for Options C to F
• proposed pricing information (26.4)
Session 3.3 - Time
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 54
• Starting, Completion and Key Dates
• Programme
• Access, stopping and starting work
3
3
Starting, Completion and Key Dates
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 55
• Contractor does not start work on site until first access date
and does work so that Completion is on or before Completion
Date (30.1)
• PM decides date of Completion and certifies within a week
(30.2)
• Contractor does work so that condition stated for each Key
Date is met by Key Date (30.3)
• Completion Date can be changed by PM as a result of
compensation events, acceleration (36) and accepting Defects
(45.2)

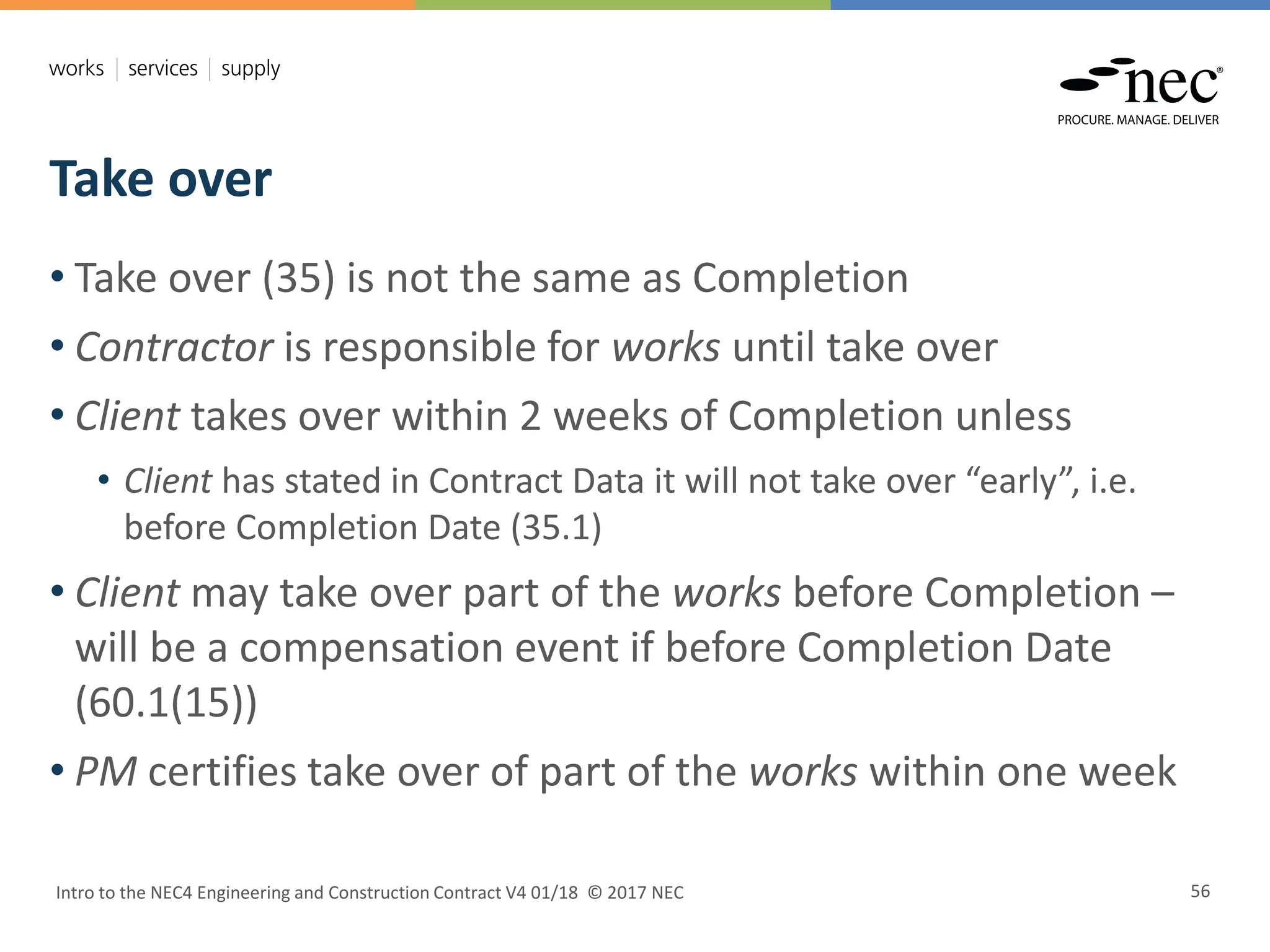

Take over
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 56
• Take over (35) is not the same as Completion
• Contractor is responsible for works until take over
• Client takes over within 2 weeks of Completion unless
• Client has stated in Contract Data it will not take over “early”, i.e.
before Completion Date (35.1)
• Client may take over part of the works before Completion –
will be a compensation event if before Completion Date
(60.1(15))
• PM certifies take over of part of the works within one week
Programme
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 57
• Can be submitted with tender or after Contract Date (31.1)
• Programme includes (31.2)
• various dates
• order and timing of operations
• order and timing of work of Client and Others
• provisions for float, time risk allowances
• for each operation, a statement of how Contractor plans to do work
identifying principal Equipment and resources
• Likely to be collection of documents which may include
resource statements, information required schedules,
network diagrams, bar charts
Accepting programme
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 58
• Programme must be accepted or not accepted by PM
within two weeks of submission
• Reasons for not accepting (31.3)
• If PM does not notify acceptance or non-acceptance
• Contractor may notify PM of failure
• if no action by PM, programme is treated as accepted
• Accepted Programme is latest programme accepted by
PM (11.2(1))
Updating programme
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 59
• Programme has to be updated regularly (32)
• Shows a number of things including the actual progress
achieved on each operation and its effect on remaining
work (32.1)
• How frequent?
• on instruction by PM
• when Contractor chooses
• at interval stated in Contract Data (32.2)
Access, and stopping and starting work
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 60
• Client allows Contractor access to the Site (33.1)
• PM can instruct Contractor to stop or not start work
(34.1)
• PM must then give instruction to
• re-starting or start work or
• remove work from Scope
• Compensation event (60.1(4)) and termination event
(91.6). Consider whether fault of Contractor
Session 3.4 – Quality management
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 61
• Quality management system
• Tests and inspections
• Searching for and notifying Defects
• Correcting Defects
• Accepting Defects
• Uncorrected Defects
4
4

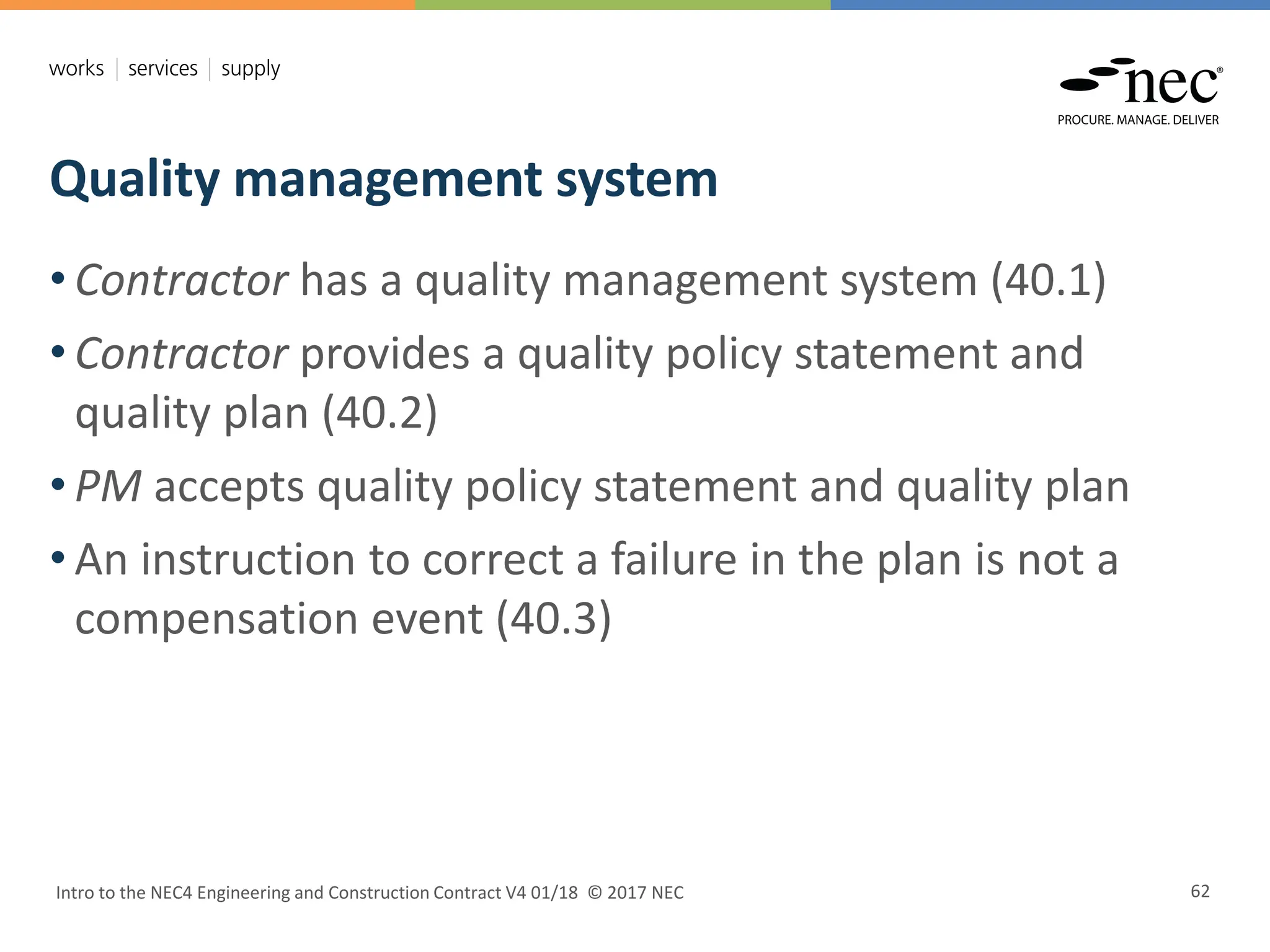

Quality management system
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 62
• Contractor has a quality management system (40.1)
• Contractor provides a quality policy statement and
quality plan (40.2)
• PM accepts quality policy statement and quality plan
• An instruction to correct a failure in the plan is not a
compensation event (40.3)
Tests and inspections

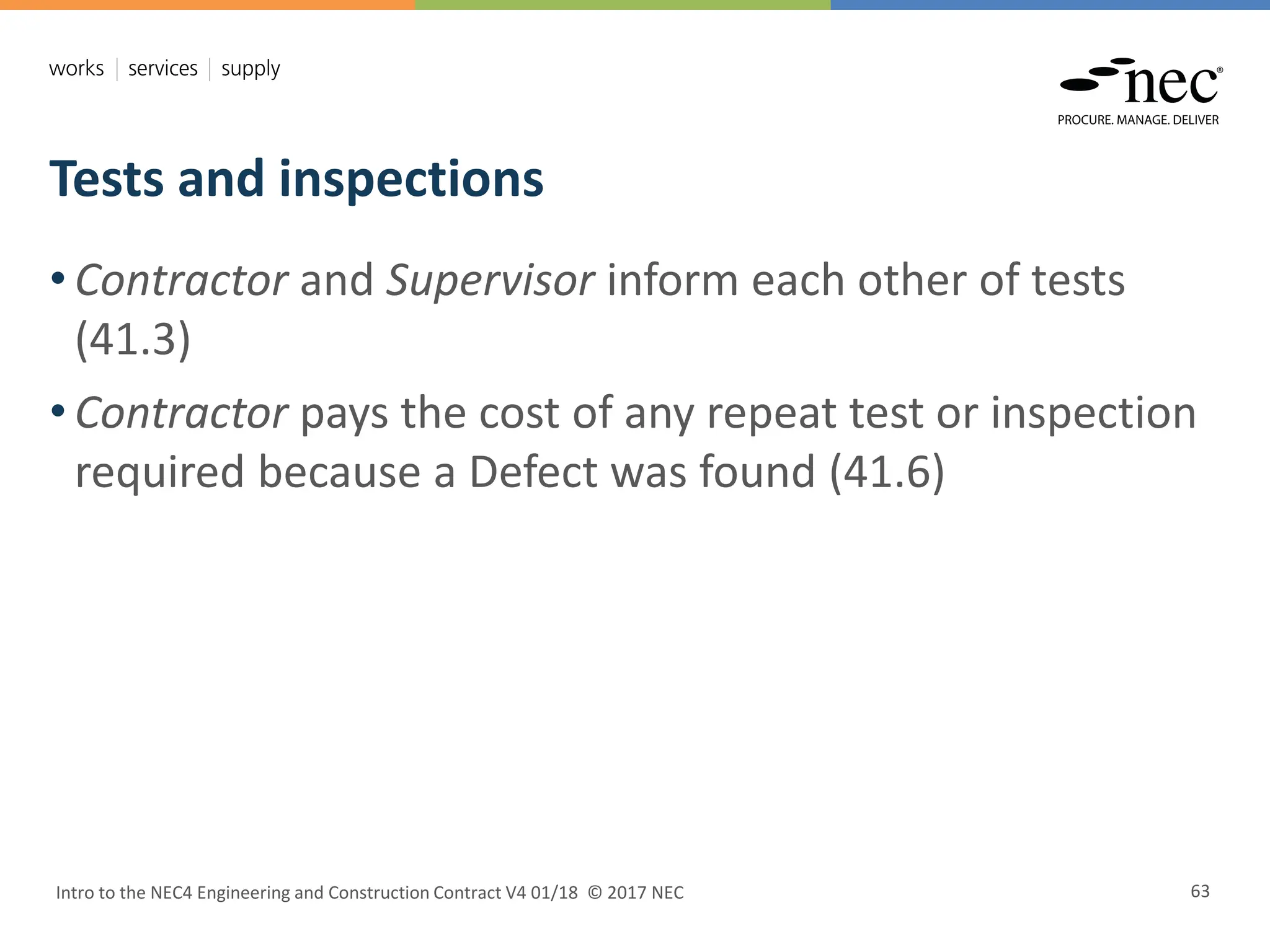

Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 63
• Contractor and Supervisor inform each other of tests
(41.3)
• Contractor pays the cost of any repeat test or inspection
required because a Defect was found (41.6)
Defects
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 64
• Searching for and notifying Defects (43)
• search provisions (43.1)
• Supervisor and Contractor notify each other as soon as they find
Defects (43.2)
• Correcting Defects (44)
• Contractor corrects notified Defects before end of defect
correction period (44.2)
• access required after take over to correct a Defect (44.4)
defect
correction
period
defect
correction
period defect
correction
period
Completion defects date
before Completion
Defects notified:
before defects date
Latest issue of
Defects Certificate
after Completion

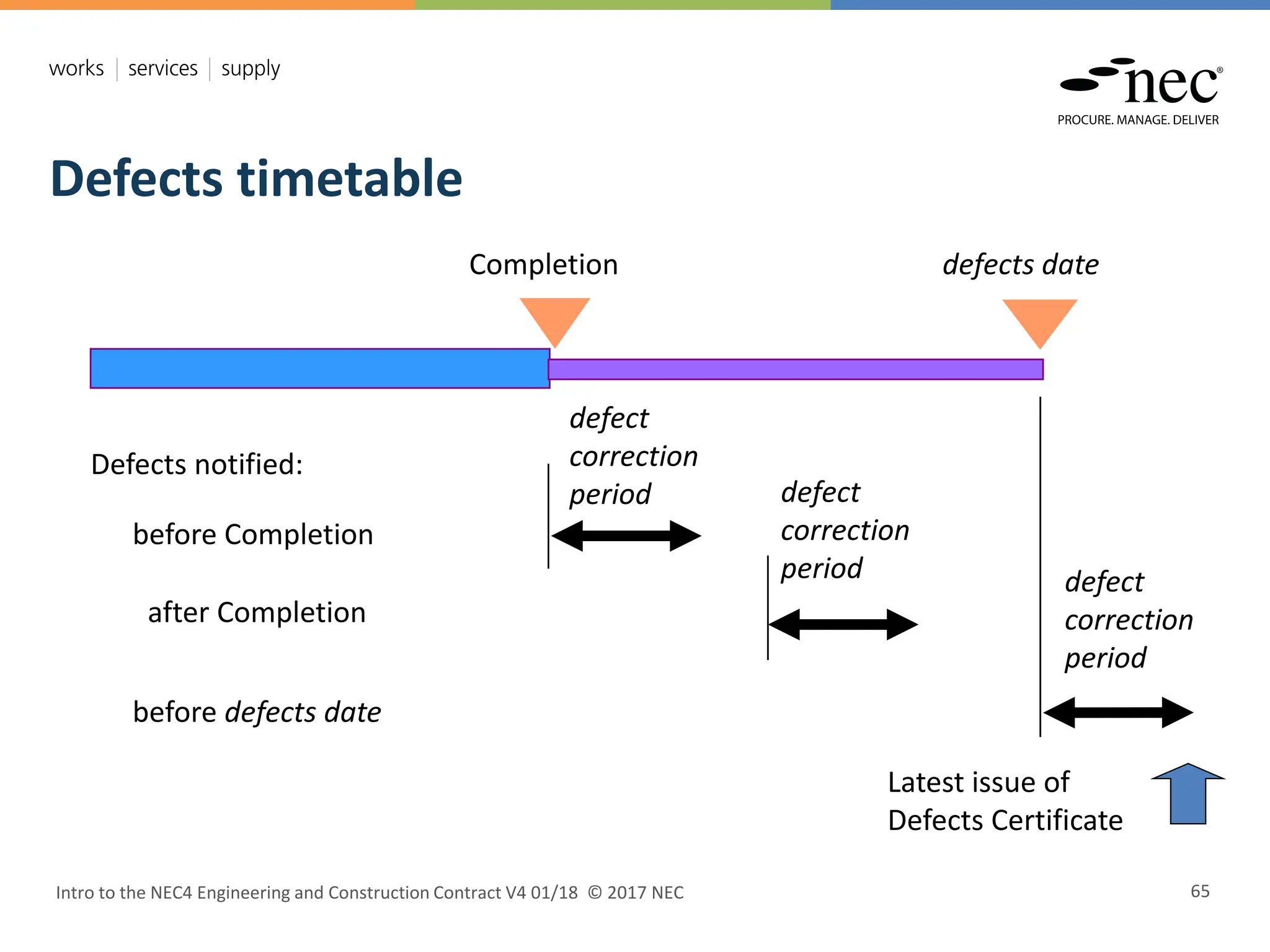

Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 65
Defects timetable
Defects
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 66
• Uncorrected Defects (46)
• if not corrected within defect correction period the PM assesses
cost to Client of correcting it and Contractor pays amount (46.1)
• Accepting Defects (45)
• proposals that Defect not corrected (45.1)
• quotation for reduced Prices and/or earlier Completion Date
(45.2)
• if quotation accepted, PM
• changes Scope, Prices and Completion Date accordingly
• accepts the revised programme
Session 3.5 - Payment
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 67
• Assessing the amount due
• Times for assessment and payment
• Schedule of Cost Components (SCC)
5
5
Assessment timetable
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 68
• Assessments made by the PM (50.1)
• First assessment no later than the assessment interval
after the starting date
• Normal assessments made at assessment interval until
• the Supervisor issues the Defects Certificate or
• the PM issues a termination certificate
• Final assessment no later than
• four weeks after Defects Certificate or
• thirteen weeks after termination certificate (53.1)

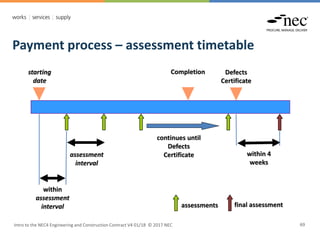

Payment process – assessment timetable
Completion
starting
date
final assessment
assessment
interval
continues until
Defects
Certificate within 4
weeks
Defects
Certificate
within
assessment
interval assessments
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 69
Assessment
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 70
• PM
• assesses amount due at each assessment date (50.1)
• considers an application for payment Contractor has submitted
(50.2)
• certifies payment within 1 week of each assessment date (51.1)
• Contractor submits an application for payment before
each assessment date
• Application includes details of how amount has been
assessed, in form stated in Scope
Assessment
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 71
• If Contractor submits application, amount due is
• Price for Work Done to Date (PWDD) plus/less other amounts
eg. retention, delay damages, KPIs (50.3)
• If Contractor does not submit an application, amount due
is lesser of
• amount PM assesses and
• amount due at the previous assessment date (50.4)
• One quarter (25%) of PWDD retained if there is no first
programme (50.5)
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 72

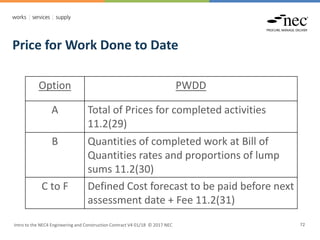

Price for Work Done to Date
Option PWDD
A Total of Prices for completed activities
11.2(29)
B Quantities of completed work at Bill of
Quantities rates and proportions of lump
sums 11.2(30)
C to F Defined Cost forecast to be paid before next
assessment date + Fee 11.2(31)
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 73

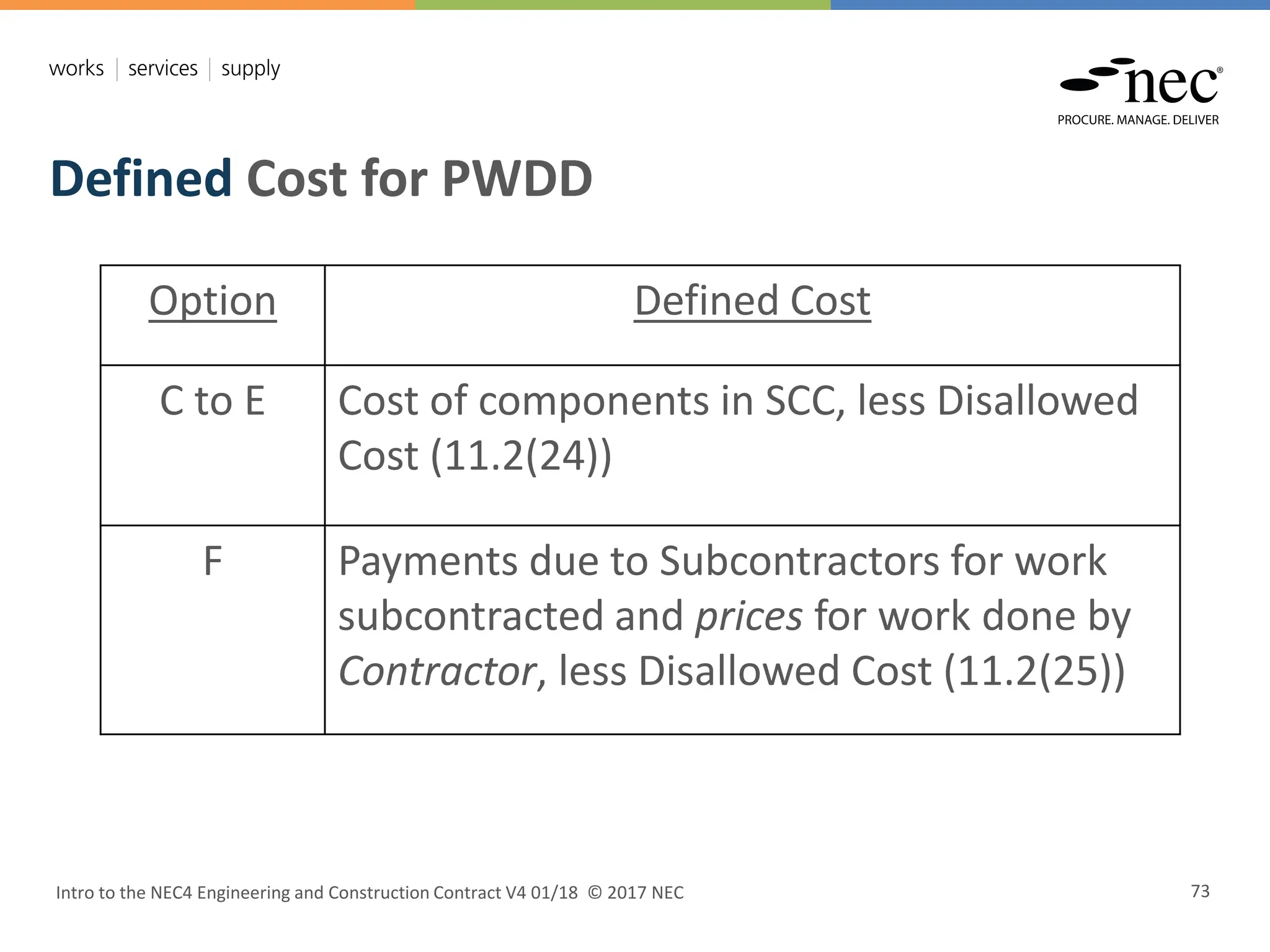

Defined Cost for PWDD
Option Defined Cost
C to E Cost of components in SCC, less Disallowed
Cost (11.2(24))
F Payments due to Subcontractors for work
subcontracted and prices for work done by
Contractor, less Disallowed Cost (11.2(25))
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 74
Disallowed Cost
Option Disallowed Cost
C to E
11.2(26)
Cost which, for example,
• is not justified by the Contractor’s accounts
• should not have been paid to Subcontractor
• was incurred only because Contractor did
not give early warning
• correcting Defects after Completion
F
11.2(27)
As C to E plus
• payment to Subcontractor for work which
Contract Data states Contractor will do itself
or Contractor’s management
Defined Cost
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 75
• Defined Cost includes only amounts
• calculated using rates and percentages stated in the Contract
Data
• other amounts at open market or competitively tendered prices
with deductions for all discounts, rebates and taxes (52.1)
• Defined Cost can be “finalised” so it is not revisited (50.9)
Fee
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 76
• All Contractor’s costs not included in Defined Cost are
treated as included in Fee (52.1)
• The Fee is calculated by applying the fee percentage to
the amount of Defined Cost (11.2(10))
PM certifies
payment
Certified
payment is
made
1 week
assessment
date
3 weeks or other
period stated in CD
Interest 51.2
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC
77
Payment – times without Y(UK)2
Note that for final assessment, the
Contractor may issue the assessment
Y2.2 due
date for
payment
Y2.2 final
date for
payment
7 days
assessment
date
7 days
14 days or other period
stated in CD
Y2.3 notice to
pay less than
PM’s assessment
Y2.5 suspension of
performance of all
or part of works
Interest 51.2
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 78
Payment – times with Y(UK)2
PM certificate -
Y2.2 notice of
payment
Note that for final assessment, the
Contractor may issue the assessment
Final assessment

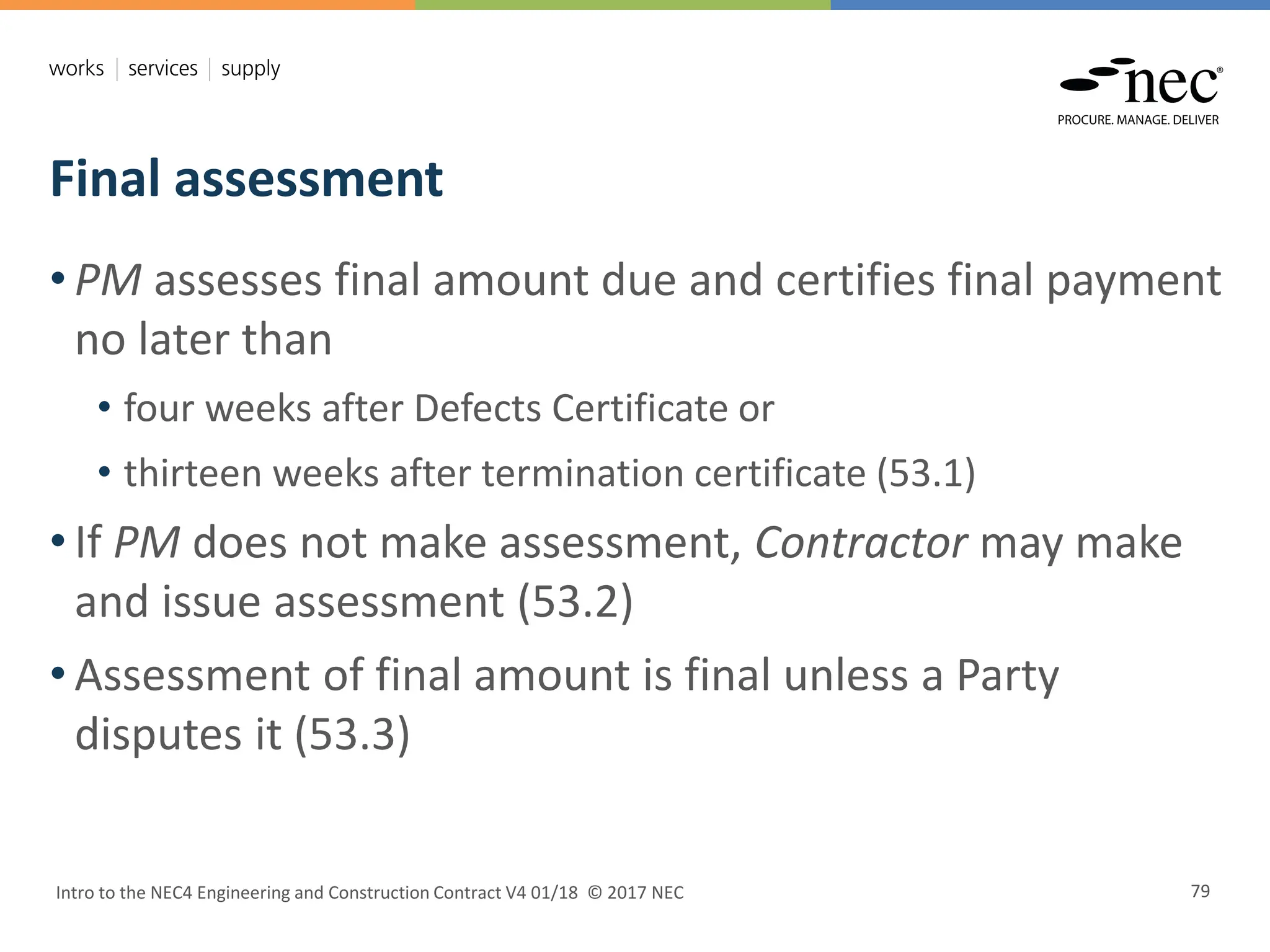

Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 79
• PM assesses final amount due and certifies final payment
no later than
• four weeks after Defects Certificate or
• thirteen weeks after termination certificate (53.1)
• If PM does not make assessment, Contractor may make
and issue assessment (53.2)
• Assessment of final amount is final unless a Party
disputes it (53.3)
Schedule of Cost Components
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 80
• Only used in Options C to E
• Used for assessing both
• compensation events and
• Price for Work Done to Date (PWDD)
• An amount is included only in one cost component and
only if incurred to Provide the Works

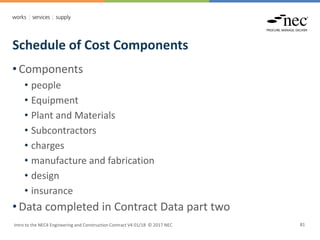

Schedule of Cost Components
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 81
• Components
• people
• Equipment
• Plant and Materials
• Subcontractors
• charges
• manufacture and fabrication
• design
• insurance
• Data completed in Contract Data part two
Session 3.6 – Compensation events
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 82
• Definition
• Process
• Method of assessment
• Short Schedule of Cost
Components (SSCC)
• Sanctions for non-compliance
6
6
Definition
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 83
• Compensation events are
• events which if they do not arise from Contractor’s fault, entitle
Contractor to be compensated for effect on the Prices, Key
Dates and Completion Date
• Therefore it is important to remember that compensation
events deal with both time and money
Definition
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 84
• Where are compensation events stated?
• 21 in clause 60.1
• 3 in main Options B and D, in clauses 60.4 to 60.6
• also in secondary Options X2, X12.3(6) & (7), X14.2, X15.2 and
Y2.5
• may be in Contract Data part one
• may be additional compensation events in secondary Option Z
• Some decisions/instructions specifically not
compensation events – for example whole life cost
changes to Scope (X21.5)
Compensation events
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 85
• Compensation events, examples 60.1
• (1) PM gives instruction changing the Scope
• (2) Client does not allow access to and use of part of the
Site
• (3) Client does not provide something
• (5) default by Client or Others
• (12) Contractor encounters certain physical conditions
• (13) a weather measurement is recorded, less frequently
than once in ten years
Process
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 86
• There is a defined process to agree (or impose) the
effects of a compensation event within defined time
limits
• Both PM and Contractor can make sure that process and
time scales are adhered to
• A separate process for instructing quotations for
proposed instructions (65)
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 87

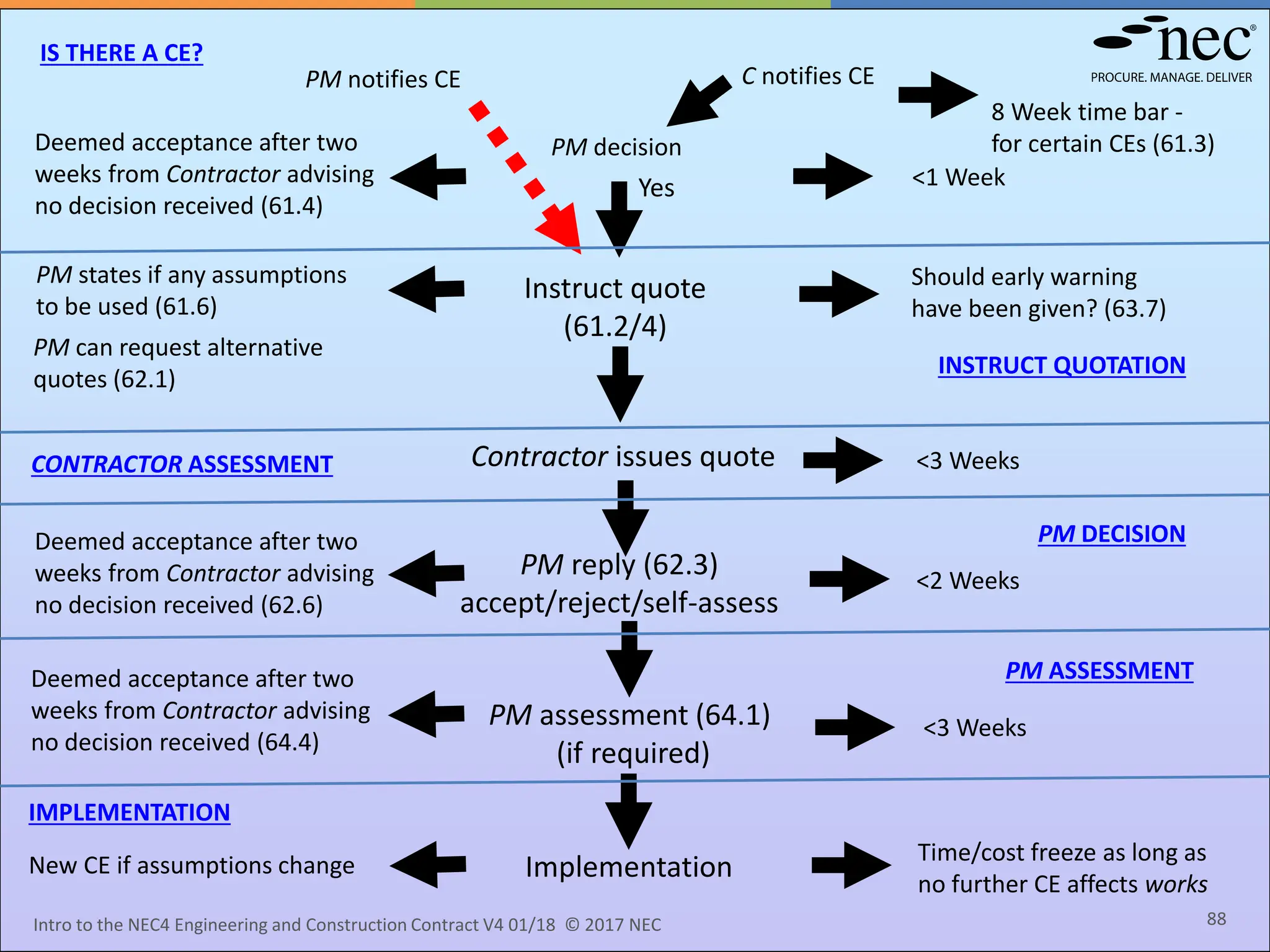

The compensation event process
Is there a CE?
(61) Instructing a quotation
(62)
Assessment by Contractor
(63) Decision by PM
(62)
Assessment by PM
(64)
Implementation
(66)
PM notifies CE
PM can request alternative
quotes (62.1)
New CE if assumptions change Time/cost freeze as long as
no further CE affects works
Implementation
PM assessment (64.1)
(if required)
Deemed acceptance after two
weeks from Contractor advising
no decision received (64.4)
Deemed acceptance after two
weeks from Contractor advising
no decision received (62.6)
PM states if any assumptions
to be used (61.6)
Deemed acceptance after two
weeks from Contractor advising
no decision received (61.4)
8 Week time bar -
for certain CEs (61.3)
Should early warning
have been given? (63.7)
<3 Weeks
<1 Week
Contractor issues quote
Instruct quote
(61.2/4)
PM decision
<3 Weeks
<2 Weeks
PM reply (62.3)
accept/reject/self-assess
IS THERE A CE?
IMPLEMENTATION
PM ASSESSMENT
INSTRUCT QUOTATION
C notifies CE
PM DECISION
CONTRACTOR ASSESSMENT

88
Yes
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC
Notification
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 89
• If the compensation event arises from PM or Supervisor
• giving instruction or notification
• issuing certificate or
• changing earlier decision
then PM notifies compensation event at time of
communication (61.1)
• PM includes in notification instruction to Contractor to
provide quotation (61.2)
• Otherwise Contractor notifies (61.3)
Notification
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 90
• When Contractor notifies, PM replies within one week with
“yes” or “no”
• Answer is “no” if PM decides event
• is Contractor’s fault
• has not happened/is not expected to happen
• is not notified in time
• has no effect on Defined Cost, Completion or meeting a Key Date or
• is not a listed compensation event (61.4)
• Otherwise answer is “yes” and includes PM instruction to
Contractor to provide a quotation (61.4)
Sanctions (1)
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 91
• Contractor inaction
• if Contractor does not notify of compensation event it is
supposed to (not one to be notified by PM) within 8 weeks of
becoming aware of event, it loses rights to any additional time
or money (61.3)
• PM inaction
• if PM fails to reply to Contractor’s notification of compensation
event within 1 week, Contractor may give PM a reminder (61.4)
• if failure continues for a further 2 weeks after reminder, deemed
that PM has accepted it is a compensation event and has
instructed a quotation to be provided (61.4)
Quotation
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 92
• When PM notifies the event as a compensation event,
included in notification is an instruction to Contractor to
provide quotation
• When instructing a quotation PM may
• instruct alternative quotations (after discussion with Contractor)
(62.1) and/or
• state assumptions on which quotation is to be based (61.6), if
effects are unclear
• Contractor provides quotation within 3 weeks (62.3),
which can be extended by agreement (62.5)
Assessment
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 93
• Change to the Prices
• actual Defined Cost of work done by dividing date
• forecast Defined Cost of work not yet done by dividing date
• resulting Fee (63.1)
• Dividing date
• if arising from instruction or notification, certificate, or changed
decision, then date of communication by PM or Supervisor
• otherwise date of notification of compensation event (63.1)
• Which Schedule of Cost Components for Defined Cost?
Calculating Defined Cost for compensation events
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 94
• Short Schedule of Cost Components (SSCC)
• only used in Options A and B
• amount is included only in one cost component and only if
incurred to Provide the Works
• same headings as SCC
• people at People Rates
• SCC used in Options C to E
Assessment
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 95
• If PM and Contractor both agree, rates and lump sums
may be used as a basis for assessment (63.2)
• Otherwise Prices or rates in the Bill of Quantities or
Activity Schedule, or from anywhere else, are NOT used
• Prices are not reduced for a compensation event that
reduces Defined Cost unless specifically stated (63.3)
Assessment
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 96
• Delay to the Completion Date
• length of time that, due to compensation event, planned
Completion is later than planned Completion shown on
Accepted Programme current at dividing date (63.5)
• Delay to a Key Date
• length of time that, due to compensation event, planned date
when Condition will be met is later than date shown on
Accepted Programme current at dividing date (63.5)
Decision by PM
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 97
• PM replies within 2 weeks of receipt of quotation (62.3)
• The reply is one of following (62.3)
• accept quotation
• not accept quotation, because it has not been prepared in
accordance with contract
• If reply is non acceptance, the PM must
• instruct Contractor to provide revised quotation (with reasons)
or
• tell Contractor it will make own assessment
Note PM cannot just issue non acceptance
Sanctions (2)
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 98
• If PM fails within allowed time to reply to quotation
Contractor may notify reminder (62.6)
• If there was more than one quotation, notification
identifies the preferred quotation
• If failure continues for a further 2 weeks after reminder,
the Contractor’s quotation is treated as having been
accepted (62.6)
PM’s assessment
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 99
• PM makes assessment if
• Contractor has not responded within time
• PM decides Contractor has not assessed compensation event
correctly
• no programme or alterations to programme submitted by
Contractor with quotation
• PM has not accepted Contractor’s latest programme (64.1)
• PM makes own assessment within the time allowed for
Contractor (64.3)
PM’s assessment
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 100
• PM assesses the programme for the remaining work in
assessment of compensation event if
• there is no Accepted Programme
• the Contractor has not submitted a programme or alteration to
the programme for acceptance
• PM has not accepted Contractor’s latest programme for a
reason stated in the contract (64.2)
Sanctions (3)
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 101
• If PM fails within allowed time to assess quotation
Contractor may notify reminder (64.4)
• If there was more than one original quotation from
Contractor, notification identifies the preferred quotation
• If failure continues for a further 2 weeks after reminder,
the Contractor’s original quotation is treated as having
been accepted (64.4)
Implementation
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 102
• Compensation event is implemented when
• PM accepts Contractor’s quotation
• PM notifies Contractor of own assessment or
• Contractor’s quotation is treated as having been accepted (66.1)
• Once implemented
• the Prices, Completion Date and Key Dates are changed accordingly
(66.2)
• the assessment is not revised (even if wrong) except as permitted by
the contract (66.3)
• only the Adjudicator or tribunal can change the assessment if one
Party still disagrees (W1/W2/W3). The Dispute Avoidance Board
cannot change the assessment
Proposed instructions
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 103
• PM may instruct a quotation for proposed instruction (65.1)
• Contractor submits quotation within three weeks (65.2)
• Quotation assessed as compensation event
• PM
• accepts quotation and notifies instruction
• instructs a revised quotation or
• notifies quotation not accepted
• If not accepted
• notification is a compensation event, so Contractor gets paid for
quotation (60.1(20))
• PM may still issue instruction and normal compensation event
process is followed (65.3)
Session 3.7 – Title
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 104
• Title
• Use of material
7
7
Title and use of material
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 105
• Whatever title Contractor has to Plant and Materials passes to
Client
• when brought into Working Areas (70.2) or
• if they are outside the Working Areas, when they are marked by
Supervisor (70.1)
• Objects and materials within Site
• PM instructs how to deal with object of value or historic or
other interest (73.1)
• Contractor has title to materials from excavation and demolition
unless stated otherwise in the Scope (73.2)
• Contractor only has restricted use of material supplied by Client
(74.1)
Session 3.8 – Liabilities and insurance
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 106
8
8
Liabilities and insurance
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 107
• 80 Client’s liabilities (damage and 3rd party claims)
• 81 Contractor’s liabilities unless stated as being the Client’s
• 82 Recovery of costs
• each Party pays for events for which they are liable
• net contribution
• 83 Insurance cover – 4 No
• 84 Insurance policies
• 86 Insurance by Client
• X18 Limitation of liability
Session 3.9 – Termination and dispute resolution
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 108
9
9
Termination
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 109
• Termination is of Contractor’s obligation to Provide the
Works (90.1)
• A Party may terminate only for reasons in Termination
Table (90.2)
• Client may terminate for any reason with Option X11
• Stated reasons for termination (91)
• Procedures on termination (92)
• Payment on termination (93)
Dispute resolution
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 110
• 3 options, W1, W2 and W3
• Choice is entered in Contract Data part one
• W1 or W3 used unless HGCRA applies
• W2 used if HGCRA applies – will concentrate on that
• W1 and W2 use adjudication as the primary means of
dispute resolution
• W3 uses a Dispute Avoidance Board established at the
start of the contract
Key points of W2
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 111
• Adjudication can be “at any time” (W2.2(1))
• Parties may refer dispute to the Senior Representatives first, by
agreement (W2.1(1))
• Adjudicator is an independent 3rd party who can be
• named in the contract, or
• agreed or appointed when the dispute arises (W2.2)
• Adjudicator has 28 days to make decision, which can be extended by
agreement (W2.3(8))
• Adjudicator’s decision is binding but not necessarily final (W2.3(11))
• Subcontract joinder possible by agreement (W2.3(3))
Tribunal
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 112
• In W2, final decision is made by tribunal named in
Contract Data part one
• arbitration or
• the courts (W2.4)
• Cannot use tribunal until after Adjudicator makes
decision (W2.4(1))
• Parties have 4 weeks after decision to notify
disagreement with it, otherwise becomes final as well as
binding (W2.4(2))
• W1 and W3 are similar
Session 4 – Summary and open forum
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 113
• Questions and answers
Were the course objectives met?
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 114
Delegates should
• Understand the philosophy of NEC
• Develop skills to advise on appropriate contract strategies
• Appreciate the use of Contract Data, Scope and Site
Information
• Understand roles and responsibilities of key parties
• Understand important ECC clauses such as early warning,
programme, communications and compensation events
Next steps?
Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 115
• Further training?
• NEC Users’ Group membership?
• Internal NEC champion?
• Share best practice – case studies/Newsletter
articles/document sharing?
Contact us
 +44 (0)20 7665 2446
 info@neccontract.com
 One Great George Street, London SW1P 3AA
neccontract.com
Delivering
real value

Introduction to the Engineering ad Construction Contract

  • 1.
    Introduction to theEngineering and Construction Contract (ECC) Delivering real value
  • 2.
    Intro to theNEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 2 NEC4: Introduction to the Engineering and Construction Contract (ECC) Introduction and housekeeping  Fire alarms  Toilets  Breaks and lunch  Who am I?  Who are you?
  • 3.
    Course agenda Intro tothe NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 3 • Welcome and introductions • Session 1 – Overview of the NEC and ECC • Session 2 – Using the ECC : the contract strategy • Session 3 – Managing the contract : the ECC processes • Session 4 – Summary and open forum
  • 4.
    Course objectives Intro tothe NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 4 Delegates should • Describe the philosophy of NEC and the behaviours needed to ensure success • Provide advice on appropriate contract strategies • Appreciate the use of Contract Data, Scope and Site Information • Define the roles and responsibilities of key parties • Apply important ECC clauses such as early warning, programme, communications and compensation events
  • 5.
    Intro to theNEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 5 Session 1 – Overview of the NEC
  • 6.
    The NEC principlesand family - review Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 6 Review Principles Documents & contracts ECSC ECS & ECSS Culture People
  • 7.
    The NEC principles Introto the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 7 • NEC is a family of standard contracts, each of which has these characteristics • stimulates good management • can be used in wide variety of commercial situations, for wide variety of types of work and in any location • a clear and simple document - using language and structure which are straightforward and easily understood
  • 8.
    Flexibility Intro to theNEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 8 • Multi-disciplinary • Responsibility for design by either party • Choice of pricing mechanisms from lump sum to cost plus • Bolt on secondary Options that allow a Client to build up the contract to suit • Allocate risks to suit • For international use
  • 9.
    Clarity and simplicity Introto the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 9 • Ordinary language • Minimal legalistic phrases • Minimised subjective phrases such as ‘fair’, ‘reasonable’ and ‘opinion’ • Reasons for decisions stated • User friendly structure
  • 10.
    Stimulus to goodmanagement Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 10 • Perhaps the most important objective. Every procedure is designed to contribute to, rather than detract from effectiveness for all parties • Founded on two principles • foresight applied collaboratively mitigates problems and shrinks risk • clear division of function and responsibility helps accountability and motivates people
  • 11.

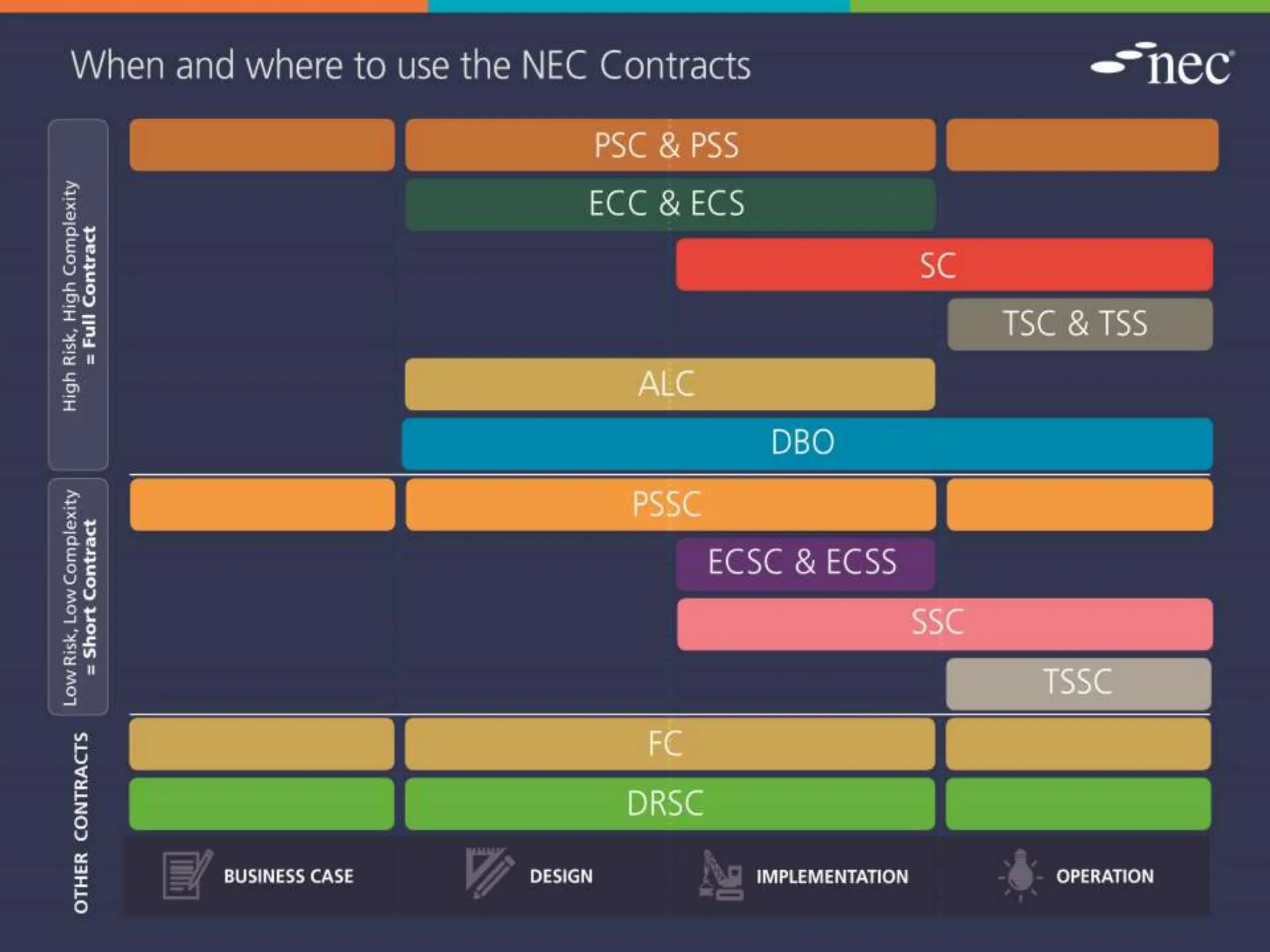

    Intro to theNEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 11
  • 12.
    User guides Intro tothe NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 12 • For all contracts • Vol 1 Establishing a procurement and contract strategy • Vol 3 Selecting a supplier • For the ECC • Vol 2 Preparing an engineering and construction contract • Vol 4 Managing an engineering and construction contract • Flow charts for the ECC - electronic only
  • 13.
    Client Project Manager PSC orPSSC Contractor ECC Adjudicator DRSC Supplier SC or SSC Subcontractor ECS or ECSS Supervisor PSC or PSSC Designer PSC or PSSC Typical Client designed arrangement Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 13
  • 14.
    Project Manager PSC orPSSC Supplier SC or SSC Subcontractor ECS or ECSS Designer PSS or PSSC Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 14 Adjudicator DRSC Contractor ECC Typical design & build arrangement Supervisor PSC or PSSC Client
  • 15.
    When to usethe short form? Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 15 • Engineering and Construction Short Contract (ECSC) is for use with contracts which • do not require sophisticated management techniques • comprise straightforward work and • impose only low risks on both the Client and the Contractor • Not necessarily low financial value • Not necessarily short duration
  • 16.
    When to usethe short form? Differences Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 16 • Only price based – equivalent to ECC Option A and B • No options – but includes • X18 - limitation of liability, in part • Y(UK)2 - Housing Grants, Construction & Regeneration Act 1996 • Most of the procedures, but less of the detail • Fewer compensation events • Either Party can notify compensation events, but Contractor submits quotation when notifying one • Contractor assesses amount due
  • 17.
    The Engineering andConstruction Subcontract (ECS) Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 17 • ECS is designed to be a back-to-back contract with ECC • ECC Client, Project Manager and Supervisor all become ECS Contractor • ECC Contractor becomes ECS Subcontractor • Most references to contract now refer to subcontract • Some timescales may change, for example for communication and payment • More detail in "Preparing an Engineering and Construction Contract – chapter 7” • Engineering and Construction Short Subcontract works in the same manner with the Engineering and Construction Contract
  • 18.
    A new culture Introto the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 18 • Teamwork • “The Parties (the Client and the Contractor), the Project Manager and the Supervisor act in a spirit of mutual trust and co-operation” (10.2) • Subcontractors • “A reason for (the Project Manager) not accepting the subcontract documents is that …. they do not include a statement that the parties to the subcontract act in a spirit of mutual trust and co-operation” (26.3) • Multiparty collaboration • “The Partners collaborate as stated in the Partnering Information and in a spirit of mutual trust and co-operation” (X12.3(1))
  • 19.
    ECC people Intro tothe NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 19 • People in contract, defined by their role • Client • Contractor • Project Manager • Supervisor • Senior Representatives ) or members of • Adjudicator ) Dispute Avoidance Board • Others (eg designers, CDM principal designer, statutory authorities) These two are the Parties to the contract
  • 20.
    Intro to theNEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 20 Session 2 – Using the ECC : the contract strategy
  • 21.
    The ECC structure Introto the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 21 • The ECC structure is modular in form with 5 modules, normally chosen by the Client • ALWAYS have the core clauses • choose ONE main Option clause (A to F) which decides the mechanism for payment and the relevant schedule of cost components • choose ONE dispute resolution Option clauses (W1, W2 or W3) • choose as many secondary Option clauses as required (prefixed X or Y) • add any additional clauses (prefixed Z)
  • 22.
    Core clauses Intro tothe NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 22 1 General 2 The Contractor’s main responsibilities 3 Time 4 Quality management 5 Payment 6 Compensation events 7 Title 8 Liabilities and insurance 9 Termination
  • 23.
    Main Option clauses Introto the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 23 • A - Priced contract with activity schedule • B - Priced contract with bill of quantities • C - Target contract with activity schedule • D - Target contract with bill of quantities • E - Cost reimbursable contract • F - Management contract
  • 24.
    Activity Schedule (OptionA) Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 24 • Lump sum contract • Project well defined at tender • Activities usually defined by Contractor • Activities priced by Contractor • Payment on completion of defined activities • Milestone payments by grouping activities • Activity Schedule can be adjusted by Contractor to reflect Scope
  • 25.
    Bill of Quantities(Option B) Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 25 • Project well defined at tender but change likely • Standard method of measurement used • Contractor prices items in Bill of Quantities at tender stage • Contractor paid for quantity of work completed • Original work is re-measured (but not necessarily changes)
  • 26.
    Target cost contracts(Options C & D) Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 26 • Work must be adequately defined to establish target • Target cost set by activity schedule (C) or bill of quantities (D) which Contractor prices at tender • Contractor tenders Fee • Target moves with compensation events (Options C & D) and remeasurement (Option D) • Contractor gets paid forecast Defined Cost + Fee • Contractor is paid or pays a share of the difference between total costs and final target, at the end of the contract
  • 27.
    Cost reimbursable contract(Option E) Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 27 • Used for example for emergency, experimental, research work where • work poorly defined at tender • work subject to extensive change • Contractor tenders Fee • Contractor paid forecast Defined Cost + Fee • Contractor has no financial risk (except adequacy of Fee)
  • 28.
    Management contract (OptionF) Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 28 • Contractor generally organises work only • Most work carried out by Subcontractors • Contractor tenders prices (lump sum) and Fee • Contractor gets paid forecast Defined Cost + Fee • Contractor has limited financial risk, except for adequacy of • Fee and • prices for work it does itself
  • 29.
    A Contractor Client B F E D C Intro to theNEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 29 Financial risk of main Options Depends on pain / gain mechanism
  • 30.
    Dispute resolution clauses Introto the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 30 • W1 - for adjudication, where the HGCR Act 1996 does not apply • W2 - for adjudication, where the HGCR Act 1996 applies • W3 - where a Dispute Avoidance Board is used
  • 31.
    Secondary Option clauses Introto the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 31 • X1 - Price adjustment for inflation • X2 - Changes in the law • X3 - Multiple currencies • X4 - Ultimate holding company guarantee • X5 - Sectional Completion • X6 - Bonus for early Completion • X7 - Delay damages • X8 - Undertakings to the Client or Others • X9 - Transfer of rights
  • 32.
    Secondary Option clauses Introto the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 32 • X10 - Information modelling • X11 - Termination by the Client • X12 - Multiparty collaboration • X13 - Performance bond • X14 - Advanced payment to the Contractor • X15 - The Contractor’s design • X16 - Retention • X17 - Low performance damages • X18 - Limitation of liability
  • 33.
    Secondary Option clauses Introto the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 33 • X20 - Key Performance Indicators • X21 - Whole life cost • X22 - Early Contractor involvement • Y(UK)1 - Project Bank Account • Y(UK)2 - The Housing Grants, Construction and Regeneration Act 1996 • Y(UK)3 - The Contracts (Rights of Third Parties) Act 1999 • Z - Additional conditions of contract
  • 34.
    Contract documents Intro tothe NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 34 • Contract Data parts one (Client) and two (Contractor) • details specifics – see template Contract Data included in delegate packs • Prices • depends on main Option chosen – include activity schedule or bill of quantities • Scope • specifies and describes the works • states any constraints on how Contractor Provides the Works • mainly specification and drawings • supplied by Client or Contractor (for design) • Site Information • describes the Site and its surroundings
  • 35.
    Other documents Intro tothe NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 35 • With Contract Data • if Option X12 is chosen - Partnering Information • if Option X20 is chosen - incentive schedule • In Scope • if Option X4 is chosen - ultimate holding company guarantee • if Option X8 is chosen - undertakings to the Client or Others • if Option X13 is used - performance bond
  • 36.
    Intro to theNEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 36 Session 3 – Managing the contract : the ECC processes Sections 1-9 1 2 3 5 6 4 9 8 7
  • 37.
    Session 3.1 –General provisions Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 37 • Actions • Identified and defined terms • Communications • Project Manager and Supervisor • Early warning • Contractor’s proposals 1 1
  • 38.
    Actions Intro to theNEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 38 • Act as stated in this contract (10.1) • obliges persons to do everything the contract states • Act in a spirit of mutual trust and co-operation (10.2) • covers obligations and attitude
  • 39.
    Identified and definedterms Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 39 • Identified terms in Contract Data are in italics • Defined terms, capitalised and in 11.2 • (1) Accepted Programme • (2) Completion (certainty of requirements) • (3) Completion Date • (5) Corrupt Act • (6) Defect (two types) • (7) Defects Certificate • (8) Early Warning Register
  • 40.
    Identified and definedterms Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 40 • (9) Equipment • (10) Fee (covers all costs not in Defined Cost (52.1)) • (11) Key Date • (14) Plant and Materials • (16) Scope • (17) Site • (18) Site Information • (19) Subcontractor • (20) Working Areas
  • 41.
    Communications Intro to theNEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 41 • Must be in a form that can be read, copied and recorded (13.1) • see simple examples in delegate packs • Use of a “communication system” (13.2) • Replies within period for reply or as in contract (13.3) • Notifications and certificates to be communicated separately (13.7)
  • 42.
    Project Manager andSupervisor Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 42 • Project Manager (PM) manages ECC for Client • PM has a great deal of authority • PM must be even handed in matters such as assessing payment • PM is only person who can instruct changes to Scope • PM constrained by need to give reasons if PM does not accept a Contractor’s submission – if reason not in contract then Contractor is compensated • Supervisor checks Contractor’s compliance with the Scope
  • 43.
    Project Manager andSupervisor Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 43 • Acceptance of any communication (programme, design etc) by the PM or Supervisor does not change the Contractor’s responsibility to Provide the Works or liability for its design (14.1) • PM or Supervisor may delegate any actions, giving details of delegation (14.2) • PM may give instruction changing the Scope or a Key Date (14.3)
  • 44.
    Early warning Intro tothe NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 44 • Contractor and PM have a duty to notify the other as soon as they are aware of a matter which could • increase the total of the Prices • delay Completion • delay meeting a Key Date or • impair the performance of the works in use (15.1) or • adversely affect the creation or use of the Information Model (X10.3) • PM or Contractor may give an early warning by notifying the other of any other matter which could increase Contractor’s total cost • PM enters early warning matters in Early Warning Register (15.1)
  • 45.
    Early warning Intro tothe NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 45 • PM prepares and issues first Early Warning Register within one week of starting date (15.2) • PM instructs first early warning meeting within two weeks of starting date • Either party may at any time instruct the other to attend later early warning meeting • Further early warning meetings occur • when instructed by a party and • no longer than intervals stated in Contract Data
  • 46.
    Early warning Intro tothe NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 46 • A Subcontractor attends if attendance will assist (15.2) • Those attending co-operate in making and considering proposals to avoid or reduce effects, seeking solutions, deciding actions, reviewing and perhaps removing matters from Early Warning Register (15.3) • PM revises Early Warning Register to record decisions and issues within one week (15.4) • Encourages collaboration, innovation and ability to adjust to circumstances during the contract
  • 47.
    Contractor’s proposals Intro tothe NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 47 • Contractor may propose changes to Client’s Scope which reduces the total of the Prices (16.1) • If the PM accepts the proposal, the PM issues an instruction changing the Scope (16.2) • For Option A and B, the benefit is shared by the value engineering percentage (63.12) if • the change is to Client’s Scope and • the total Defined Cost is reduced by the compensation event • The PM does not change the Scope as proposed unless it accepts the quotation
  • 48.
    Session 3.2 -Contractor’s main responsibilities Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 48 • Providing the Works • Contractor’s design • People • Working with the Client and Others • Subcontracting 2 2
  • 49.
    Works Intro to theNEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 49 • Providing the Works (20) • Contractor Provides the Works in accordance with the Scope
  • 50.
    Design Intro to theNEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 50 • Contractor’s design (21) • Contractor designs the parts of the works which the Scope states it is to design • default is Client design • design acceptance before proceeding • reasons for not accepting design • Using the design (22) • Contractor owns its rights (22.1) unless Option X9 adopted • Design liability • Contractor may have limited design liability (Option X15)
  • 51.
    People Intro to theNEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 51 • The Contractor • employs each key person stated in Contract Data or • employs replacement person accepted by PM (24.1) • Reasons for not accepting (24.1) • PM may instruct removal of a person (24.2)
  • 52.
    Working with Clientand Others – Key Dates Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 52 • Contractor co-operates with Others (25.1) • Multi-contract projects are coordinated through use of Key Dates, by which stated conditions have to be met • If the PM decides (25.3) • work does not meet Condition stated for a Key Date by the date stated and • Client incurs additional cost the additional cost is paid by Contractor • Optional – no obligation to use Key Dates
  • 53.
    Subcontracting Intro to theNEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 53 • If subcontracts, Contractor still responsible for Providing the Works (26.1) • Contractor submits for all Options • name of each proposed Subcontractor to PM for acceptance (26.2) • proposed subcontract documents except pricing information unless • NEC contract is proposed, unamended except for changes in main contract, or • PM agrees no submission required (26.3) • Contractor additionally submits for Options C to F • proposed pricing information (26.4)
  • 54.
    Session 3.3 -Time Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 54 • Starting, Completion and Key Dates • Programme • Access, stopping and starting work 3 3
  • 55.
    Starting, Completion andKey Dates Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 55 • Contractor does not start work on site until first access date and does work so that Completion is on or before Completion Date (30.1) • PM decides date of Completion and certifies within a week (30.2) • Contractor does work so that condition stated for each Key Date is met by Key Date (30.3) • Completion Date can be changed by PM as a result of compensation events, acceleration (36) and accepting Defects (45.2)
  • 56.
    Take over Intro tothe NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 56 • Take over (35) is not the same as Completion • Contractor is responsible for works until take over • Client takes over within 2 weeks of Completion unless • Client has stated in Contract Data it will not take over “early”, i.e. before Completion Date (35.1) • Client may take over part of the works before Completion – will be a compensation event if before Completion Date (60.1(15)) • PM certifies take over of part of the works within one week
  • 57.
    Programme Intro to theNEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 57 • Can be submitted with tender or after Contract Date (31.1) • Programme includes (31.2) • various dates • order and timing of operations • order and timing of work of Client and Others • provisions for float, time risk allowances • for each operation, a statement of how Contractor plans to do work identifying principal Equipment and resources • Likely to be collection of documents which may include resource statements, information required schedules, network diagrams, bar charts
  • 58.
    Accepting programme Intro tothe NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 58 • Programme must be accepted or not accepted by PM within two weeks of submission • Reasons for not accepting (31.3) • If PM does not notify acceptance or non-acceptance • Contractor may notify PM of failure • if no action by PM, programme is treated as accepted • Accepted Programme is latest programme accepted by PM (11.2(1))
  • 59.
    Updating programme Intro tothe NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 59 • Programme has to be updated regularly (32) • Shows a number of things including the actual progress achieved on each operation and its effect on remaining work (32.1) • How frequent? • on instruction by PM • when Contractor chooses • at interval stated in Contract Data (32.2)
  • 60.
    Access, and stoppingand starting work Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 60 • Client allows Contractor access to the Site (33.1) • PM can instruct Contractor to stop or not start work (34.1) • PM must then give instruction to • re-starting or start work or • remove work from Scope • Compensation event (60.1(4)) and termination event (91.6). Consider whether fault of Contractor
  • 61.
    Session 3.4 –Quality management Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 61 • Quality management system • Tests and inspections • Searching for and notifying Defects • Correcting Defects • Accepting Defects • Uncorrected Defects 4 4
  • 62.
    Quality management system Introto the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 62 • Contractor has a quality management system (40.1) • Contractor provides a quality policy statement and quality plan (40.2) • PM accepts quality policy statement and quality plan • An instruction to correct a failure in the plan is not a compensation event (40.3)
  • 63.
    Tests and inspections Introto the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 63 • Contractor and Supervisor inform each other of tests (41.3) • Contractor pays the cost of any repeat test or inspection required because a Defect was found (41.6)
  • 64.
    Defects Intro to theNEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 64 • Searching for and notifying Defects (43) • search provisions (43.1) • Supervisor and Contractor notify each other as soon as they find Defects (43.2) • Correcting Defects (44) • Contractor corrects notified Defects before end of defect correction period (44.2) • access required after take over to correct a Defect (44.4)
  • 65.
    defect correction period defect correction period defect correction period Completion defectsdate before Completion Defects notified: before defects date Latest issue of Defects Certificate after Completion Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 65 Defects timetable
  • 66.
    Defects Intro to theNEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 66 • Uncorrected Defects (46) • if not corrected within defect correction period the PM assesses cost to Client of correcting it and Contractor pays amount (46.1) • Accepting Defects (45) • proposals that Defect not corrected (45.1) • quotation for reduced Prices and/or earlier Completion Date (45.2) • if quotation accepted, PM • changes Scope, Prices and Completion Date accordingly • accepts the revised programme
  • 67.
    Session 3.5 -Payment Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 67 • Assessing the amount due • Times for assessment and payment • Schedule of Cost Components (SCC) 5 5
  • 68.
    Assessment timetable Intro tothe NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 68 • Assessments made by the PM (50.1) • First assessment no later than the assessment interval after the starting date • Normal assessments made at assessment interval until • the Supervisor issues the Defects Certificate or • the PM issues a termination certificate • Final assessment no later than • four weeks after Defects Certificate or • thirteen weeks after termination certificate (53.1)
  • 69.
    Payment process –assessment timetable Completion starting date final assessment assessment interval continues until Defects Certificate within 4 weeks Defects Certificate within assessment interval assessments Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 69
  • 70.
    Assessment Intro to theNEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 70 • PM • assesses amount due at each assessment date (50.1) • considers an application for payment Contractor has submitted (50.2) • certifies payment within 1 week of each assessment date (51.1) • Contractor submits an application for payment before each assessment date • Application includes details of how amount has been assessed, in form stated in Scope
  • 71.
    Assessment Intro to theNEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 71 • If Contractor submits application, amount due is • Price for Work Done to Date (PWDD) plus/less other amounts eg. retention, delay damages, KPIs (50.3) • If Contractor does not submit an application, amount due is lesser of • amount PM assesses and • amount due at the previous assessment date (50.4) • One quarter (25%) of PWDD retained if there is no first programme (50.5)
  • 72.
    Intro to theNEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 72 Price for Work Done to Date Option PWDD A Total of Prices for completed activities 11.2(29) B Quantities of completed work at Bill of Quantities rates and proportions of lump sums 11.2(30) C to F Defined Cost forecast to be paid before next assessment date + Fee 11.2(31)
  • 73.
    Intro to theNEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 73 Defined Cost for PWDD Option Defined Cost C to E Cost of components in SCC, less Disallowed Cost (11.2(24)) F Payments due to Subcontractors for work subcontracted and prices for work done by Contractor, less Disallowed Cost (11.2(25))
  • 74.
    Intro to theNEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 74 Disallowed Cost Option Disallowed Cost C to E 11.2(26) Cost which, for example, • is not justified by the Contractor’s accounts • should not have been paid to Subcontractor • was incurred only because Contractor did not give early warning • correcting Defects after Completion F 11.2(27) As C to E plus • payment to Subcontractor for work which Contract Data states Contractor will do itself or Contractor’s management
  • 75.
    Defined Cost Intro tothe NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 75 • Defined Cost includes only amounts • calculated using rates and percentages stated in the Contract Data • other amounts at open market or competitively tendered prices with deductions for all discounts, rebates and taxes (52.1) • Defined Cost can be “finalised” so it is not revisited (50.9)
  • 76.
    Fee Intro to theNEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 76 • All Contractor’s costs not included in Defined Cost are treated as included in Fee (52.1) • The Fee is calculated by applying the fee percentage to the amount of Defined Cost (11.2(10))
  • 77.
    PM certifies payment Certified payment is made 1week assessment date 3 weeks or other period stated in CD Interest 51.2 Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 77 Payment – times without Y(UK)2 Note that for final assessment, the Contractor may issue the assessment
  • 78.
    Y2.2 due date for payment Y2.2final date for payment 7 days assessment date 7 days 14 days or other period stated in CD Y2.3 notice to pay less than PM’s assessment Y2.5 suspension of performance of all or part of works Interest 51.2 Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 78 Payment – times with Y(UK)2 PM certificate - Y2.2 notice of payment Note that for final assessment, the Contractor may issue the assessment
  • 79.
    Final assessment Intro tothe NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 79 • PM assesses final amount due and certifies final payment no later than • four weeks after Defects Certificate or • thirteen weeks after termination certificate (53.1) • If PM does not make assessment, Contractor may make and issue assessment (53.2) • Assessment of final amount is final unless a Party disputes it (53.3)
  • 80.
    Schedule of CostComponents Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 80 • Only used in Options C to E • Used for assessing both • compensation events and • Price for Work Done to Date (PWDD) • An amount is included only in one cost component and only if incurred to Provide the Works
  • 81.
    Schedule of CostComponents Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 81 • Components • people • Equipment • Plant and Materials • Subcontractors • charges • manufacture and fabrication • design • insurance • Data completed in Contract Data part two
  • 82.
    Session 3.6 –Compensation events Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 82 • Definition • Process • Method of assessment • Short Schedule of Cost Components (SSCC) • Sanctions for non-compliance 6 6
  • 83.
    Definition Intro to theNEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 83 • Compensation events are • events which if they do not arise from Contractor’s fault, entitle Contractor to be compensated for effect on the Prices, Key Dates and Completion Date • Therefore it is important to remember that compensation events deal with both time and money
  • 84.
    Definition Intro to theNEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 84 • Where are compensation events stated? • 21 in clause 60.1 • 3 in main Options B and D, in clauses 60.4 to 60.6 • also in secondary Options X2, X12.3(6) & (7), X14.2, X15.2 and Y2.5 • may be in Contract Data part one • may be additional compensation events in secondary Option Z • Some decisions/instructions specifically not compensation events – for example whole life cost changes to Scope (X21.5)
  • 85.
    Compensation events Intro tothe NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 85 • Compensation events, examples 60.1 • (1) PM gives instruction changing the Scope • (2) Client does not allow access to and use of part of the Site • (3) Client does not provide something • (5) default by Client or Others • (12) Contractor encounters certain physical conditions • (13) a weather measurement is recorded, less frequently than once in ten years
  • 86.
    Process Intro to theNEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 86 • There is a defined process to agree (or impose) the effects of a compensation event within defined time limits • Both PM and Contractor can make sure that process and time scales are adhered to • A separate process for instructing quotations for proposed instructions (65)
  • 87.
    Intro to theNEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 87 The compensation event process Is there a CE? (61) Instructing a quotation (62) Assessment by Contractor (63) Decision by PM (62) Assessment by PM (64) Implementation (66)
  • 88.
    PM notifies CE PMcan request alternative quotes (62.1) New CE if assumptions change Time/cost freeze as long as no further CE affects works Implementation PM assessment (64.1) (if required) Deemed acceptance after two weeks from Contractor advising no decision received (64.4) Deemed acceptance after two weeks from Contractor advising no decision received (62.6) PM states if any assumptions to be used (61.6) Deemed acceptance after two weeks from Contractor advising no decision received (61.4) 8 Week time bar - for certain CEs (61.3) Should early warning have been given? (63.7) <3 Weeks <1 Week Contractor issues quote Instruct quote (61.2/4) PM decision <3 Weeks <2 Weeks PM reply (62.3) accept/reject/self-assess IS THERE A CE? IMPLEMENTATION PM ASSESSMENT INSTRUCT QUOTATION C notifies CE PM DECISION CONTRACTOR ASSESSMENT 88 Yes Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC
  • 89.
    Notification Intro to theNEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 89 • If the compensation event arises from PM or Supervisor • giving instruction or notification • issuing certificate or • changing earlier decision then PM notifies compensation event at time of communication (61.1) • PM includes in notification instruction to Contractor to provide quotation (61.2) • Otherwise Contractor notifies (61.3)
  • 90.
    Notification Intro to theNEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 90 • When Contractor notifies, PM replies within one week with “yes” or “no” • Answer is “no” if PM decides event • is Contractor’s fault • has not happened/is not expected to happen • is not notified in time • has no effect on Defined Cost, Completion or meeting a Key Date or • is not a listed compensation event (61.4) • Otherwise answer is “yes” and includes PM instruction to Contractor to provide a quotation (61.4)
  • 91.
    Sanctions (1) Intro tothe NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 91 • Contractor inaction • if Contractor does not notify of compensation event it is supposed to (not one to be notified by PM) within 8 weeks of becoming aware of event, it loses rights to any additional time or money (61.3) • PM inaction • if PM fails to reply to Contractor’s notification of compensation event within 1 week, Contractor may give PM a reminder (61.4) • if failure continues for a further 2 weeks after reminder, deemed that PM has accepted it is a compensation event and has instructed a quotation to be provided (61.4)
  • 92.
    Quotation Intro to theNEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 92 • When PM notifies the event as a compensation event, included in notification is an instruction to Contractor to provide quotation • When instructing a quotation PM may • instruct alternative quotations (after discussion with Contractor) (62.1) and/or • state assumptions on which quotation is to be based (61.6), if effects are unclear • Contractor provides quotation within 3 weeks (62.3), which can be extended by agreement (62.5)
  • 93.
    Assessment Intro to theNEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 93 • Change to the Prices • actual Defined Cost of work done by dividing date • forecast Defined Cost of work not yet done by dividing date • resulting Fee (63.1) • Dividing date • if arising from instruction or notification, certificate, or changed decision, then date of communication by PM or Supervisor • otherwise date of notification of compensation event (63.1) • Which Schedule of Cost Components for Defined Cost?
  • 94.
    Calculating Defined Costfor compensation events Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 94 • Short Schedule of Cost Components (SSCC) • only used in Options A and B • amount is included only in one cost component and only if incurred to Provide the Works • same headings as SCC • people at People Rates • SCC used in Options C to E
  • 95.
    Assessment Intro to theNEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 95 • If PM and Contractor both agree, rates and lump sums may be used as a basis for assessment (63.2) • Otherwise Prices or rates in the Bill of Quantities or Activity Schedule, or from anywhere else, are NOT used • Prices are not reduced for a compensation event that reduces Defined Cost unless specifically stated (63.3)
  • 96.
    Assessment Intro to theNEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 96 • Delay to the Completion Date • length of time that, due to compensation event, planned Completion is later than planned Completion shown on Accepted Programme current at dividing date (63.5) • Delay to a Key Date • length of time that, due to compensation event, planned date when Condition will be met is later than date shown on Accepted Programme current at dividing date (63.5)
  • 97.
    Decision by PM Introto the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 97 • PM replies within 2 weeks of receipt of quotation (62.3) • The reply is one of following (62.3) • accept quotation • not accept quotation, because it has not been prepared in accordance with contract • If reply is non acceptance, the PM must • instruct Contractor to provide revised quotation (with reasons) or • tell Contractor it will make own assessment Note PM cannot just issue non acceptance
  • 98.
    Sanctions (2) Intro tothe NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 98 • If PM fails within allowed time to reply to quotation Contractor may notify reminder (62.6) • If there was more than one quotation, notification identifies the preferred quotation • If failure continues for a further 2 weeks after reminder, the Contractor’s quotation is treated as having been accepted (62.6)
  • 99.
    PM’s assessment Intro tothe NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 99 • PM makes assessment if • Contractor has not responded within time • PM decides Contractor has not assessed compensation event correctly • no programme or alterations to programme submitted by Contractor with quotation • PM has not accepted Contractor’s latest programme (64.1) • PM makes own assessment within the time allowed for Contractor (64.3)
  • 100.
    PM’s assessment Intro tothe NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 100 • PM assesses the programme for the remaining work in assessment of compensation event if • there is no Accepted Programme • the Contractor has not submitted a programme or alteration to the programme for acceptance • PM has not accepted Contractor’s latest programme for a reason stated in the contract (64.2)
  • 101.
    Sanctions (3) Intro tothe NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 101 • If PM fails within allowed time to assess quotation Contractor may notify reminder (64.4) • If there was more than one original quotation from Contractor, notification identifies the preferred quotation • If failure continues for a further 2 weeks after reminder, the Contractor’s original quotation is treated as having been accepted (64.4)
  • 102.
    Implementation Intro to theNEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 102 • Compensation event is implemented when • PM accepts Contractor’s quotation • PM notifies Contractor of own assessment or • Contractor’s quotation is treated as having been accepted (66.1) • Once implemented • the Prices, Completion Date and Key Dates are changed accordingly (66.2) • the assessment is not revised (even if wrong) except as permitted by the contract (66.3) • only the Adjudicator or tribunal can change the assessment if one Party still disagrees (W1/W2/W3). The Dispute Avoidance Board cannot change the assessment
  • 103.
    Proposed instructions Intro tothe NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 103 • PM may instruct a quotation for proposed instruction (65.1) • Contractor submits quotation within three weeks (65.2) • Quotation assessed as compensation event • PM • accepts quotation and notifies instruction • instructs a revised quotation or • notifies quotation not accepted • If not accepted • notification is a compensation event, so Contractor gets paid for quotation (60.1(20)) • PM may still issue instruction and normal compensation event process is followed (65.3)
  • 104.
    Session 3.7 –Title Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 104 • Title • Use of material 7 7
  • 105.
    Title and useof material Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 105 • Whatever title Contractor has to Plant and Materials passes to Client • when brought into Working Areas (70.2) or • if they are outside the Working Areas, when they are marked by Supervisor (70.1) • Objects and materials within Site • PM instructs how to deal with object of value or historic or other interest (73.1) • Contractor has title to materials from excavation and demolition unless stated otherwise in the Scope (73.2) • Contractor only has restricted use of material supplied by Client (74.1)
  • 106.
    Session 3.8 –Liabilities and insurance Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 106 8 8
  • 107.
    Liabilities and insurance Introto the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 107 • 80 Client’s liabilities (damage and 3rd party claims) • 81 Contractor’s liabilities unless stated as being the Client’s • 82 Recovery of costs • each Party pays for events for which they are liable • net contribution • 83 Insurance cover – 4 No • 84 Insurance policies • 86 Insurance by Client • X18 Limitation of liability
  • 108.
    Session 3.9 –Termination and dispute resolution Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 108 9 9
  • 109.
    Termination Intro to theNEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 109 • Termination is of Contractor’s obligation to Provide the Works (90.1) • A Party may terminate only for reasons in Termination Table (90.2) • Client may terminate for any reason with Option X11 • Stated reasons for termination (91) • Procedures on termination (92) • Payment on termination (93)
  • 110.
    Dispute resolution Intro tothe NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 110 • 3 options, W1, W2 and W3 • Choice is entered in Contract Data part one • W1 or W3 used unless HGCRA applies • W2 used if HGCRA applies – will concentrate on that • W1 and W2 use adjudication as the primary means of dispute resolution • W3 uses a Dispute Avoidance Board established at the start of the contract
  • 111.
    Key points ofW2 Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 111 • Adjudication can be “at any time” (W2.2(1)) • Parties may refer dispute to the Senior Representatives first, by agreement (W2.1(1)) • Adjudicator is an independent 3rd party who can be • named in the contract, or • agreed or appointed when the dispute arises (W2.2) • Adjudicator has 28 days to make decision, which can be extended by agreement (W2.3(8)) • Adjudicator’s decision is binding but not necessarily final (W2.3(11)) • Subcontract joinder possible by agreement (W2.3(3))
  • 112.
    Tribunal Intro to theNEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 112 • In W2, final decision is made by tribunal named in Contract Data part one • arbitration or • the courts (W2.4) • Cannot use tribunal until after Adjudicator makes decision (W2.4(1)) • Parties have 4 weeks after decision to notify disagreement with it, otherwise becomes final as well as binding (W2.4(2)) • W1 and W3 are similar
  • 113.
    Session 4 –Summary and open forum Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 113 • Questions and answers
  • 114.
    Were the courseobjectives met? Intro to the NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 114 Delegates should • Understand the philosophy of NEC • Develop skills to advise on appropriate contract strategies • Appreciate the use of Contract Data, Scope and Site Information • Understand roles and responsibilities of key parties • Understand important ECC clauses such as early warning, programme, communications and compensation events
  • 115.
    Next steps? Intro tothe NEC4 Engineering and Construction Contract V4 01/18 © 2017 NEC 115 • Further training? • NEC Users’ Group membership? • Internal NEC champion? • Share best practice – case studies/Newsletter articles/document sharing?
  • 116.
    Contact us  +44(0)20 7665 2446  info@neccontract.com  One Great George Street, London SW1P 3AA neccontract.com Delivering real value
