Deltek Users
Group Meeting
March 2014
http://www.bcsprosoft.com
Improving Billing
Processes And
Performance
http://www.bcsprosoft.com
Today, we’re going to talk about
several areas in Vision that affect
Billing and Billing Processes and
Procedures.
The first is Timesheets…
http://www.bcsprosoft.com

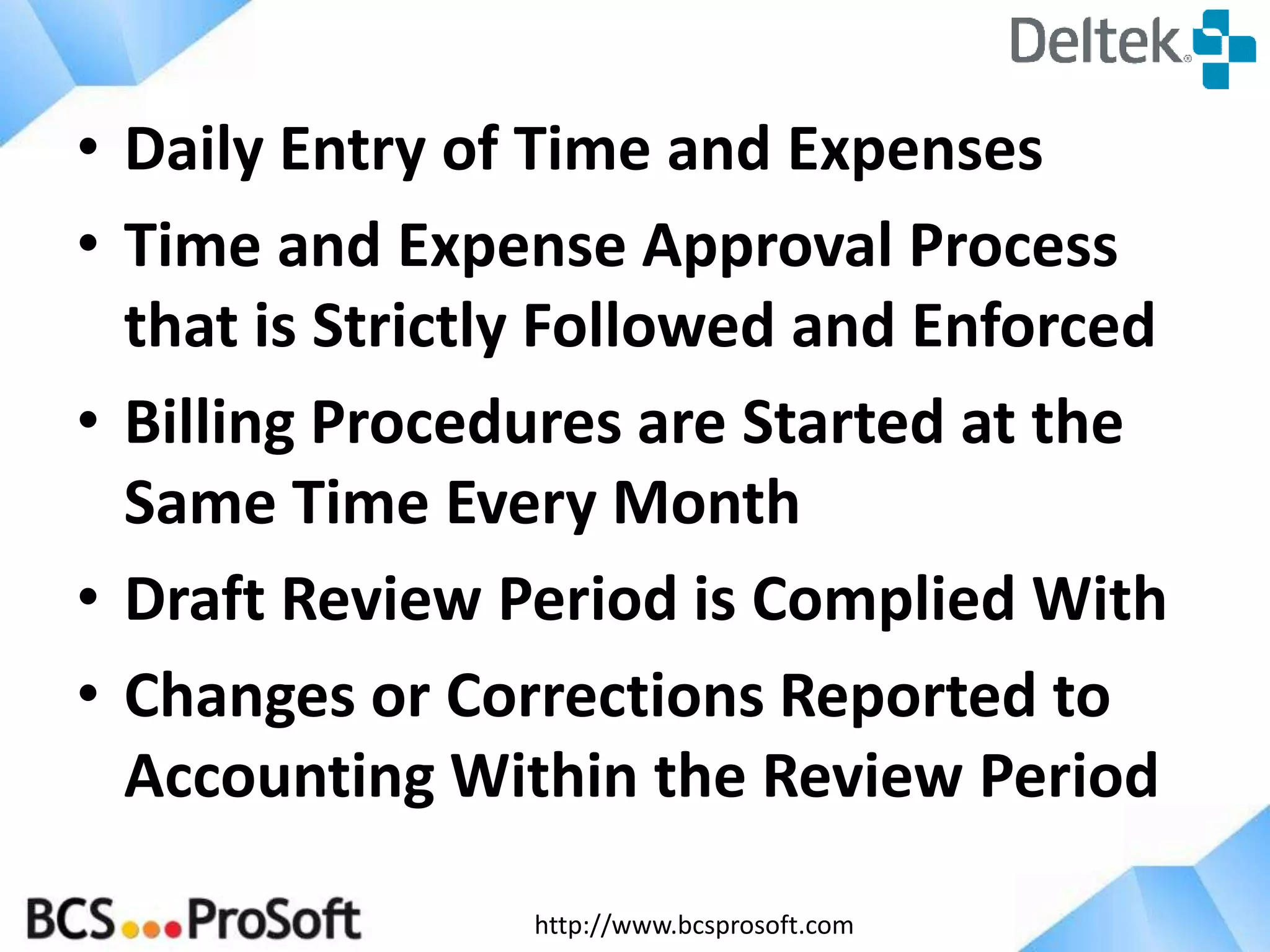

• Daily Entry of Time and Expenses
• Time and Expense Approval Process
that is Strictly Followed and Enforced
• Billing Procedures are Started at the
Same Time Every Month
• Draft Review Period is Complied With
• Changes or Corrections Reported to
Accounting Within the Review Period
http://www.bcsprosoft.com
The second area is the
Pre Billing Process.
http://www.bcsprosoft.com
• Post all time and expense transactions
to be billed
• Run draft invoices and pre-bill reports
• Have an invoice approval process in
place
• Make adjustments and get final invoices
processed

Pre Bill Process
http://www.bcsprosoft.com

Find an effective report within Vision for
all principals and project managers to use
for review:
• Under Billing Reports
–Fee Remaining Report
–Unbilled Detail Report
• Under Project Reports
–Office Earnings Report
–Project Earnings Report
Billing Procedures
http://www.bcsprosoft.com
• User defined tab was added to the Project Info Center
called “Billing Instructions” a memo field for PMs to
enter notes for each of their projects
• A Pre Bill report (created from the Office Earnings
report) was saved as a global report, search was Project
Manager is Me.
• When accounting finished all time and expense postings,
an email went out to the PMs to run their report and
enter their notes
• The PM sent accounting an email when this was done
• Accounting made any changes and processed the final
invoices

Example 1 of Pre Bill Process:
http://www.bcsprosoft.com
• When accounting completes posting of
all time and expenses, draft invoices and
the unbilled detail report are run
through Batch Billing, printed and given
to the project managers
• PMs mark up the drafts and return to
accounting for final invoices to be
processed

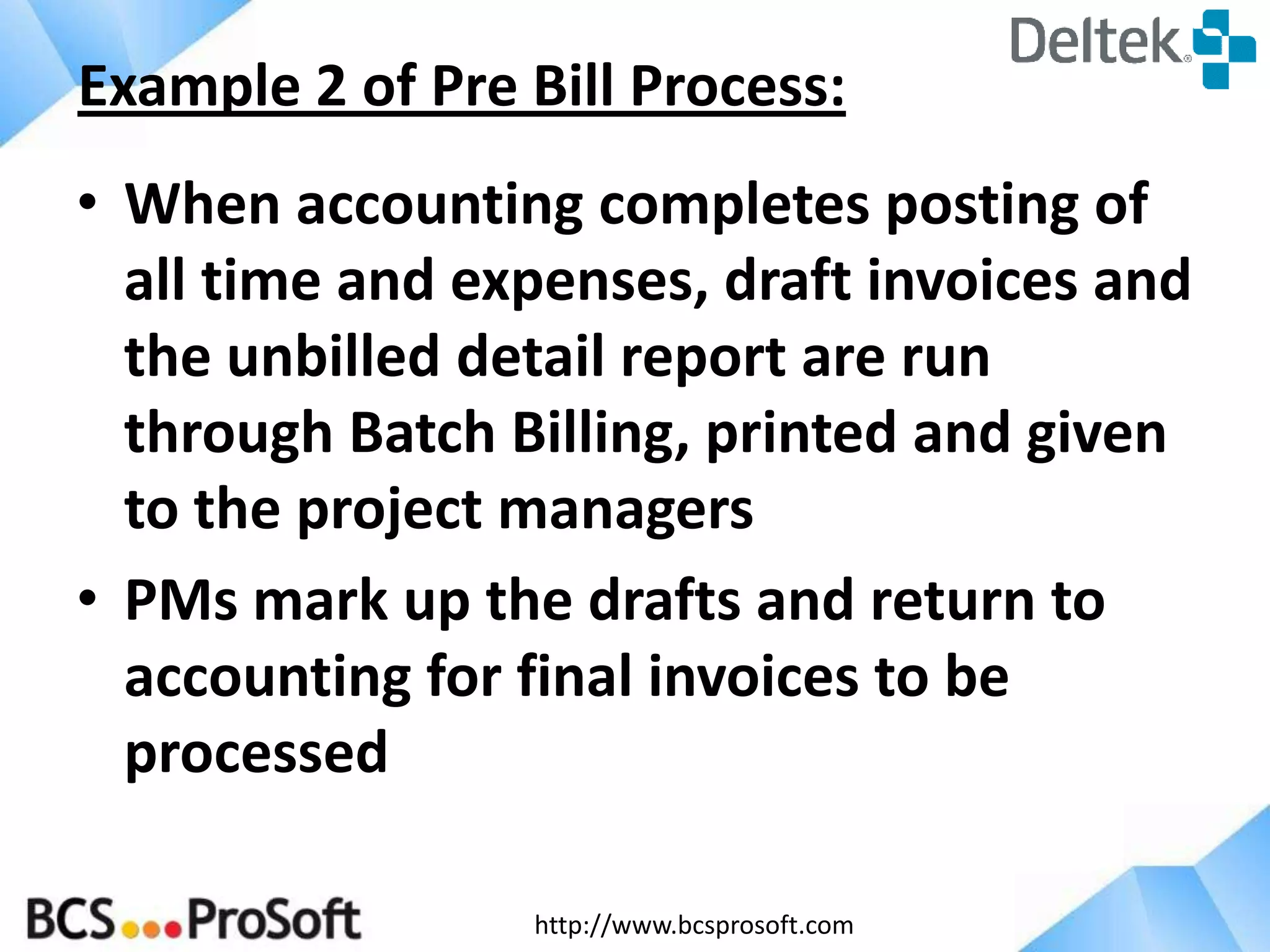

Example 2 of Pre Bill Process:
http://www.bcsprosoft.com
Now, let’s look at Billing
Terms…
http://www.bcsprosoft.com

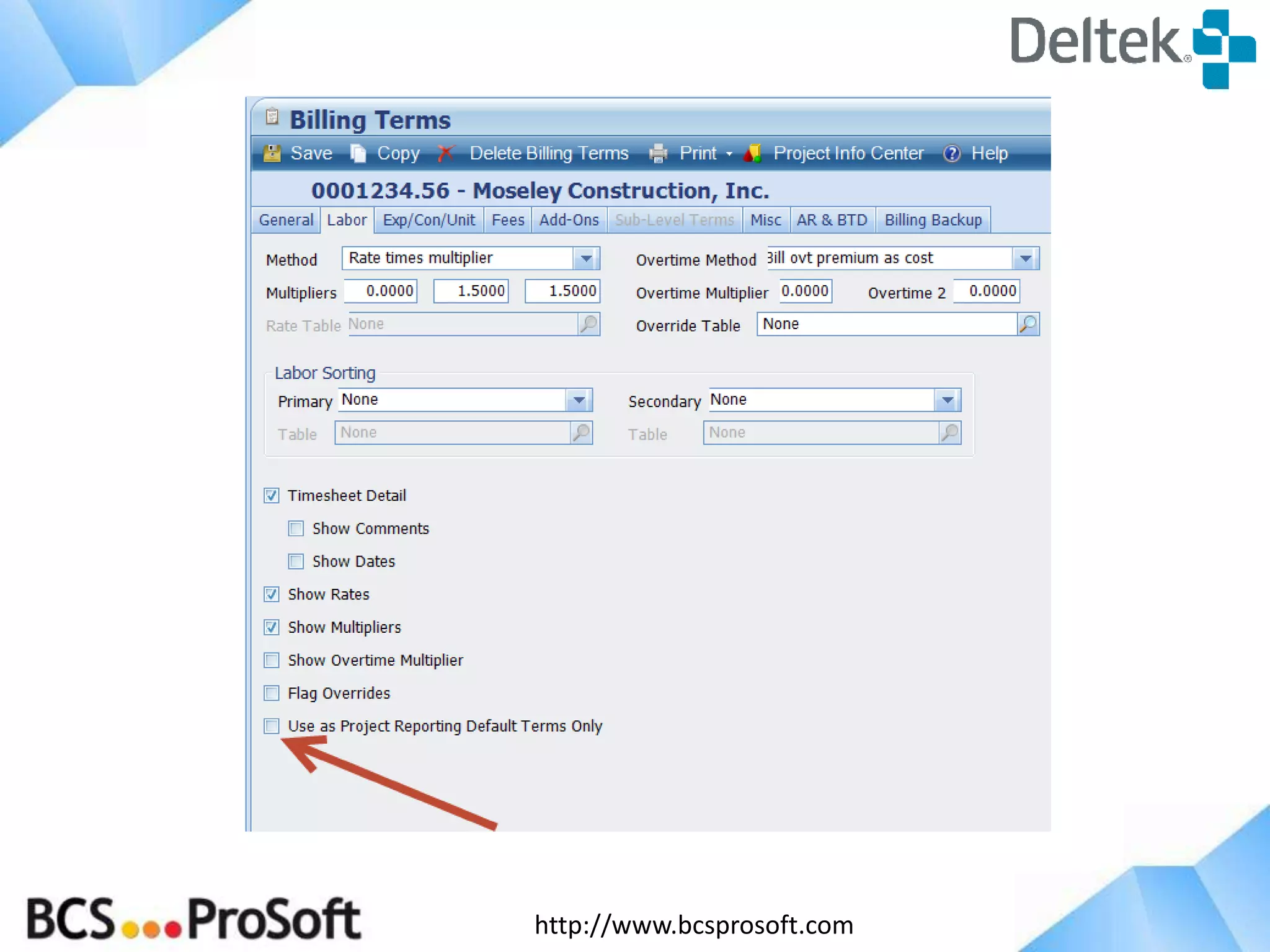

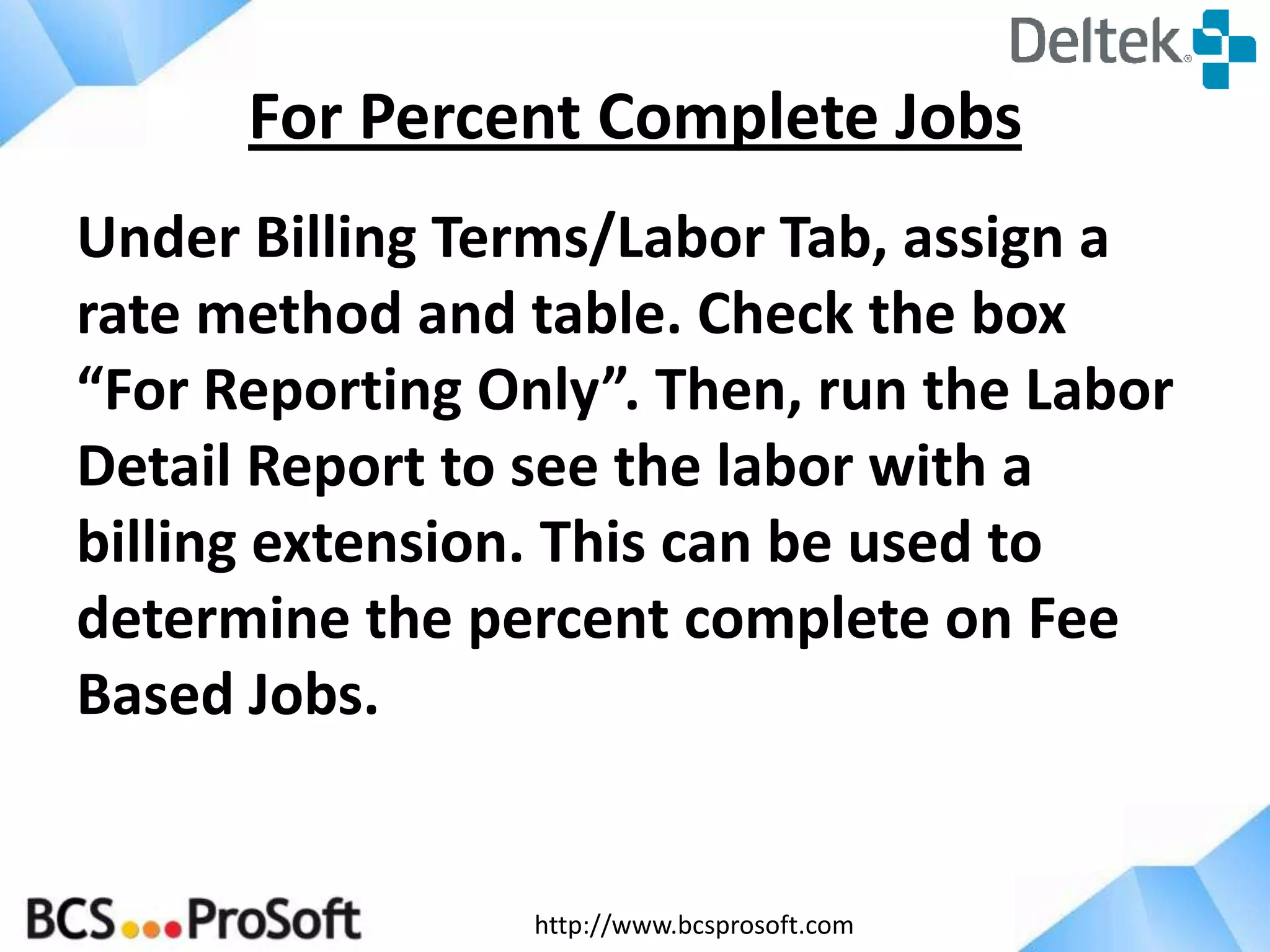

Under Billing Terms/Labor Tab, assign a
rate method and table. Check the box
“For Reporting Only”. Then, run the Labor
Detail Report to see the labor with a
billing extension. This can be used to
determine the percent complete on Fee
Based Jobs.
For Percent Complete Jobs
http://www.bcsprosoft.com
http://www.bcsprosoft.com
• Using WBS for entering time and
expense is an excellent way to
track work as it’s done on the
project
• Billing at the lowest WBS might
Not be the best option
Work Breakdown Structure (WBS)
http://www.bcsprosoft.com
When a project is set up with
phases and tasks and you try to
bill at the project level, Vision will
pull in the first phase name and
number on the invoice. To avoid
this problem, insert a 000 Phase
called Project Accounting.
http://www.bcsprosoft.com
Billing Rate Tables…
http://www.bcsprosoft.com

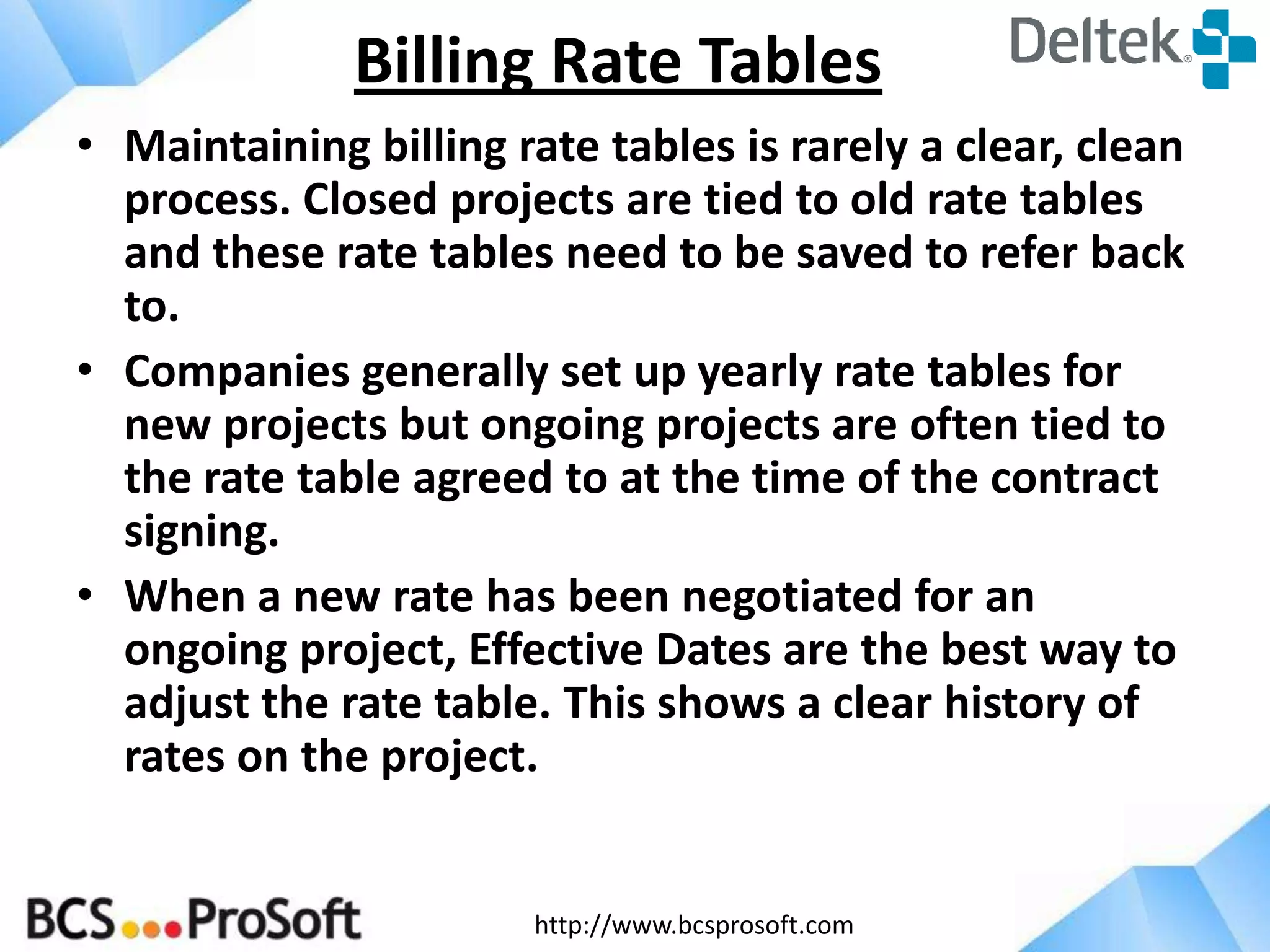

• Maintaining billing rate tables is rarely a clear, clean
process. Closed projects are tied to old rate tables
and these rate tables need to be saved to refer back
to.
• Companies generally set up yearly rate tables for
new projects but ongoing projects are often tied to
the rate table agreed to at the time of the contract
signing.
• When a new rate has been negotiated for an
ongoing project, Effective Dates are the best way to
adjust the rate table. This shows a clear history of
rates on the project.
Billing Rate Tables
http://www.bcsprosoft.com

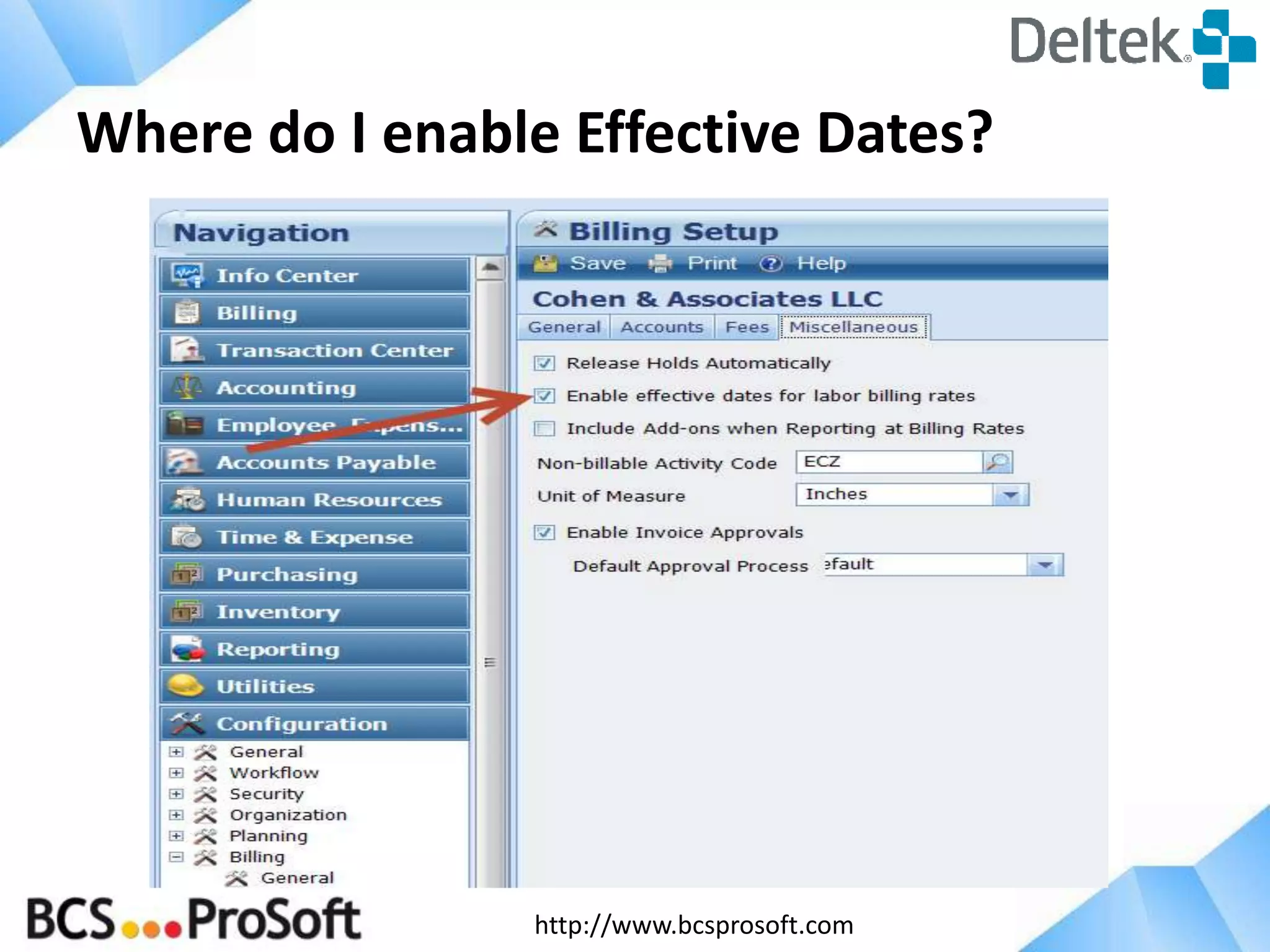

Where do I enable Effective Dates?
http://www.bcsprosoft.com
New for Billing in v7…
http://www.bcsprosoft.com

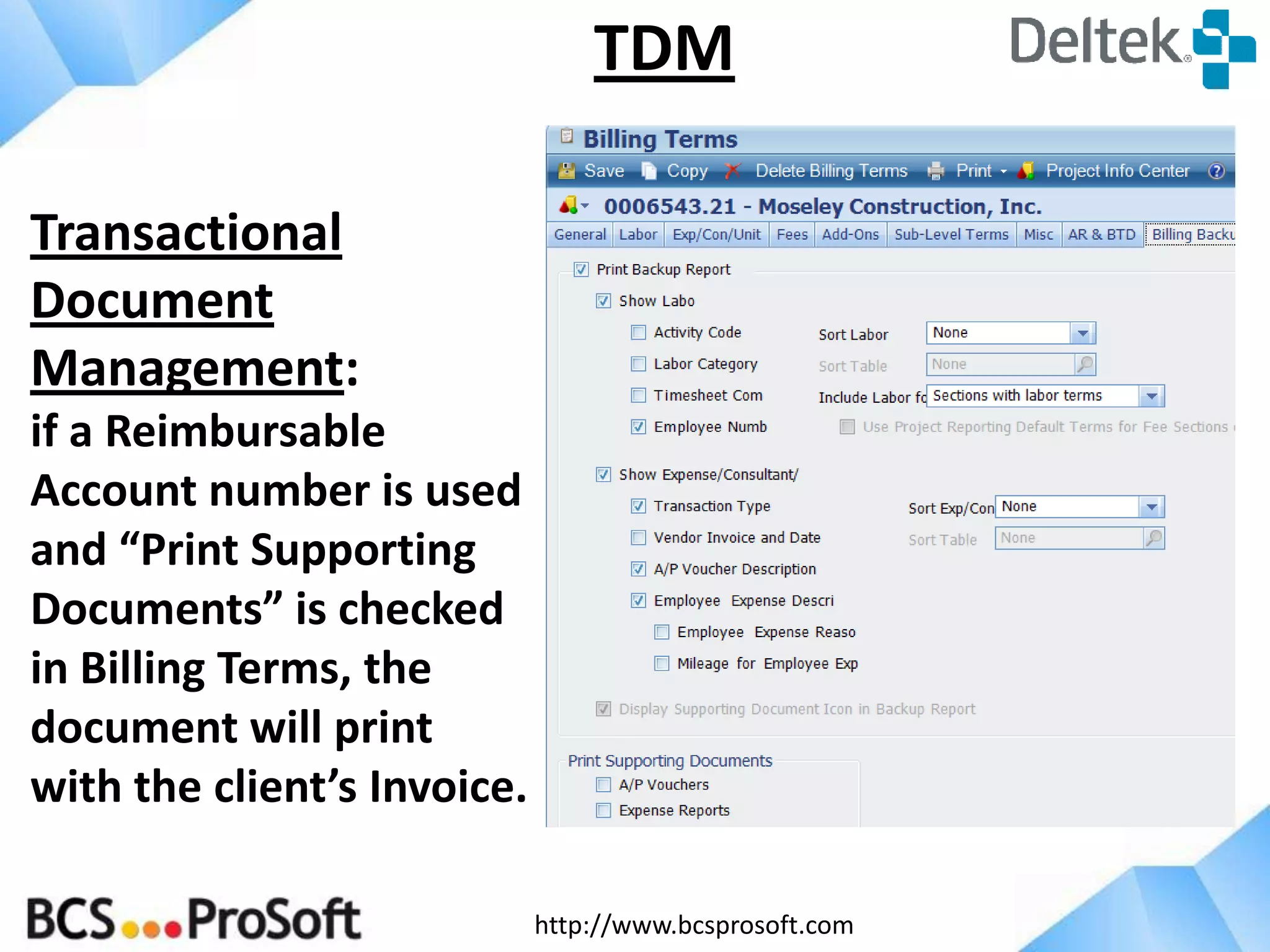

TDM
Transactional
Document
Management:
if a Reimbursable
Account number is used
and “Print Supporting
Documents” is checked
in Billing Terms, the
document will print
with the client’s Invoice.
http://www.bcsprosoft.com
1. Speeds up the Invoicing Process
2. Organizes and Automates the process
from Drafts to the Final Accepted Invoice
3. Alerts Key Participants to the Next Step
4. Documents and Retains Comments
5. Allows Delegation of Approval
6. Brings the Invoice Approval Process Into
Vision

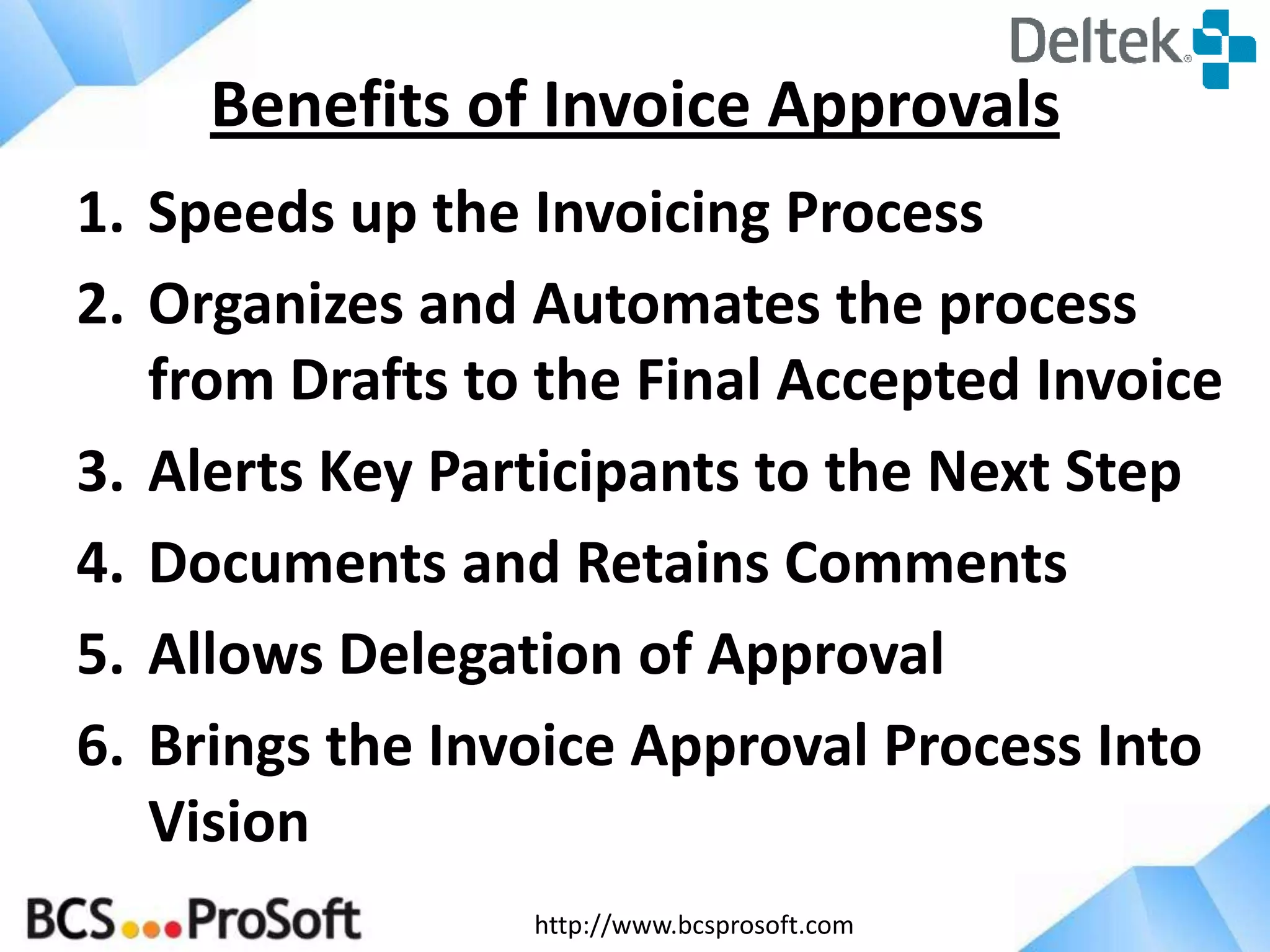

Benefits of Invoice Approvals
http://www.bcsprosoft.com

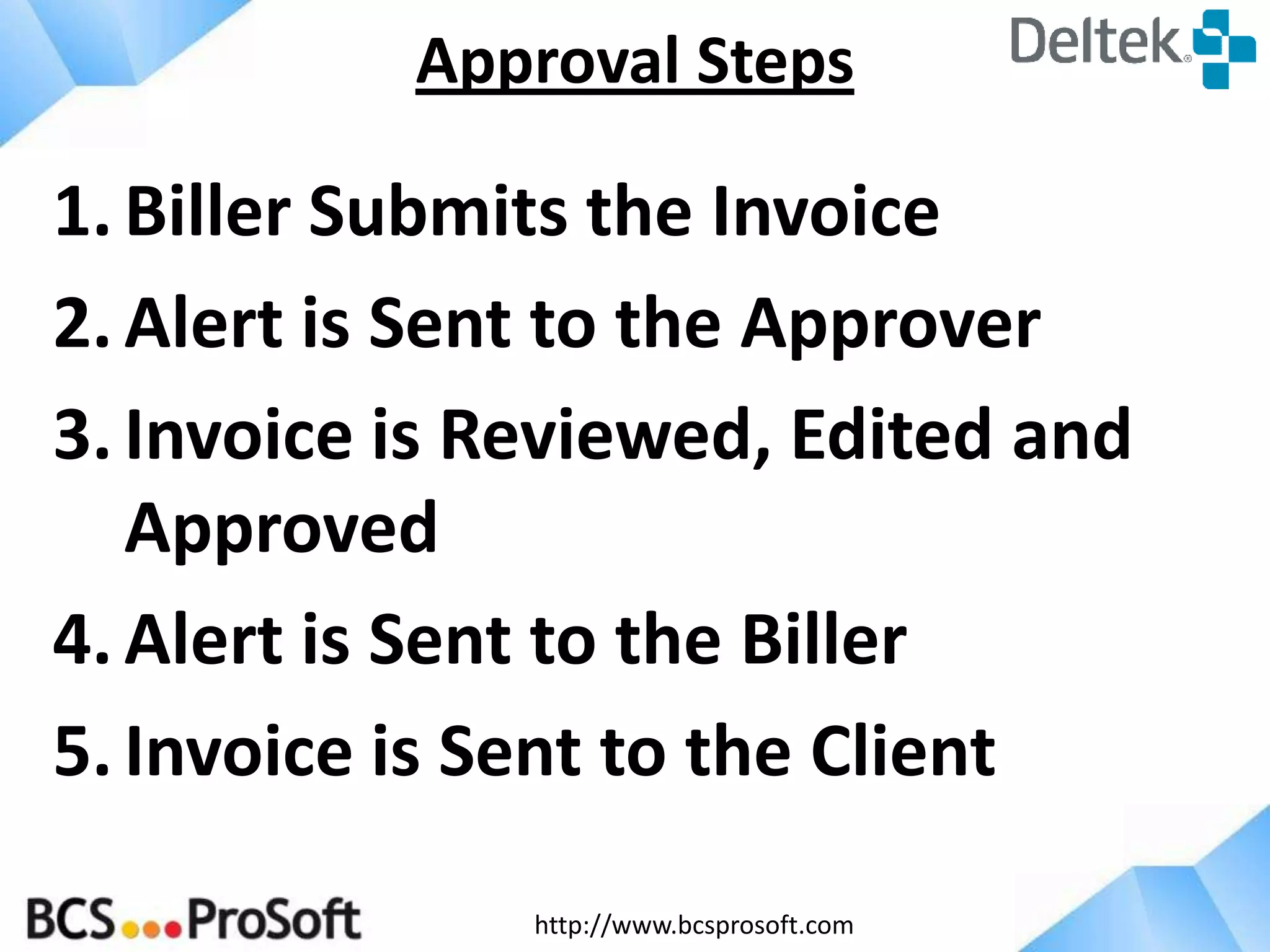

1.Biller Submits the Invoice
2.Alert is Sent to the Approver
3.Invoice is Reviewed, Edited and
Approved
4.Alert is Sent to the Biller
5.Invoice is Sent to the Client
Approval Steps
http://www.bcsprosoft.com

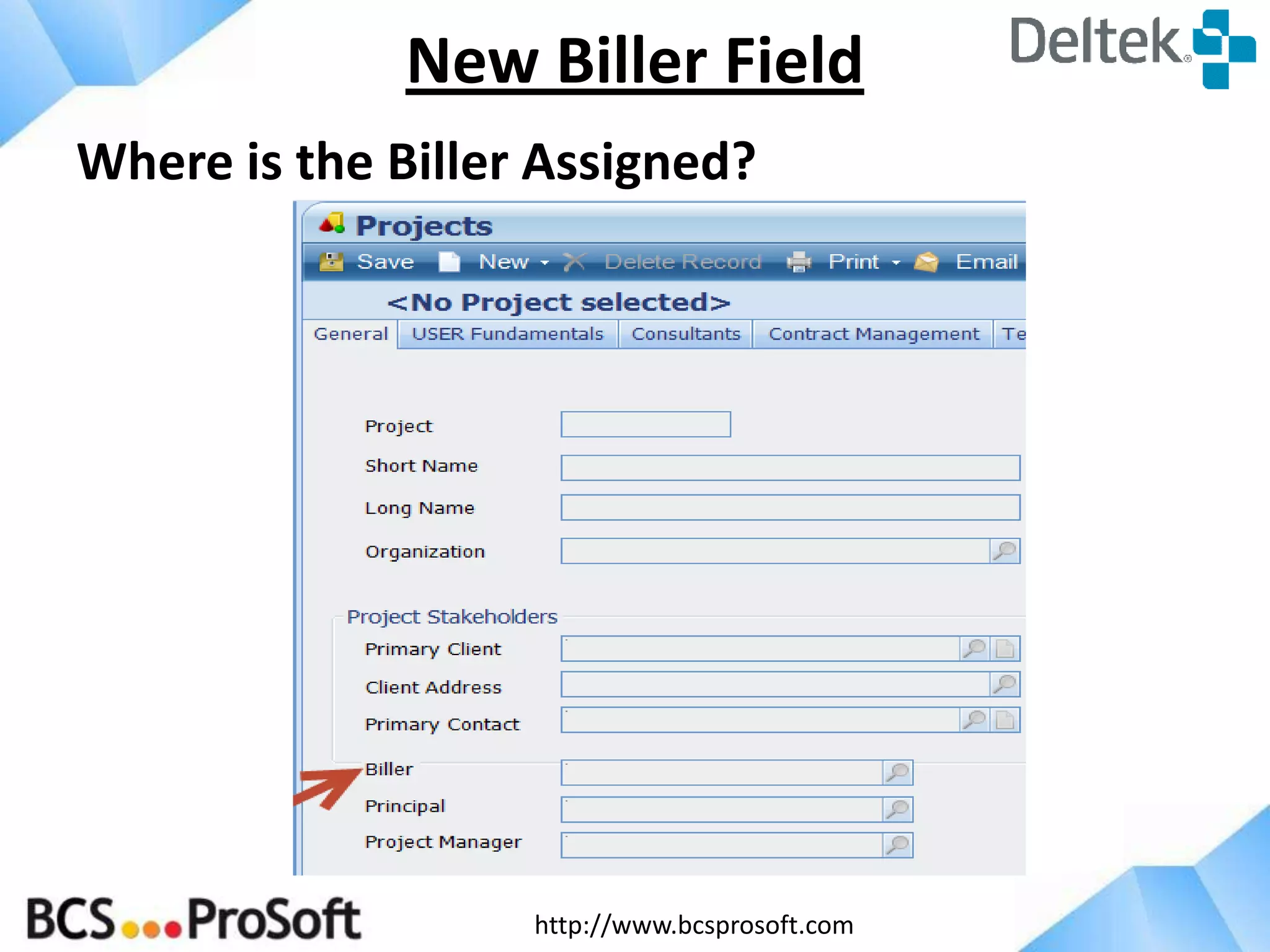

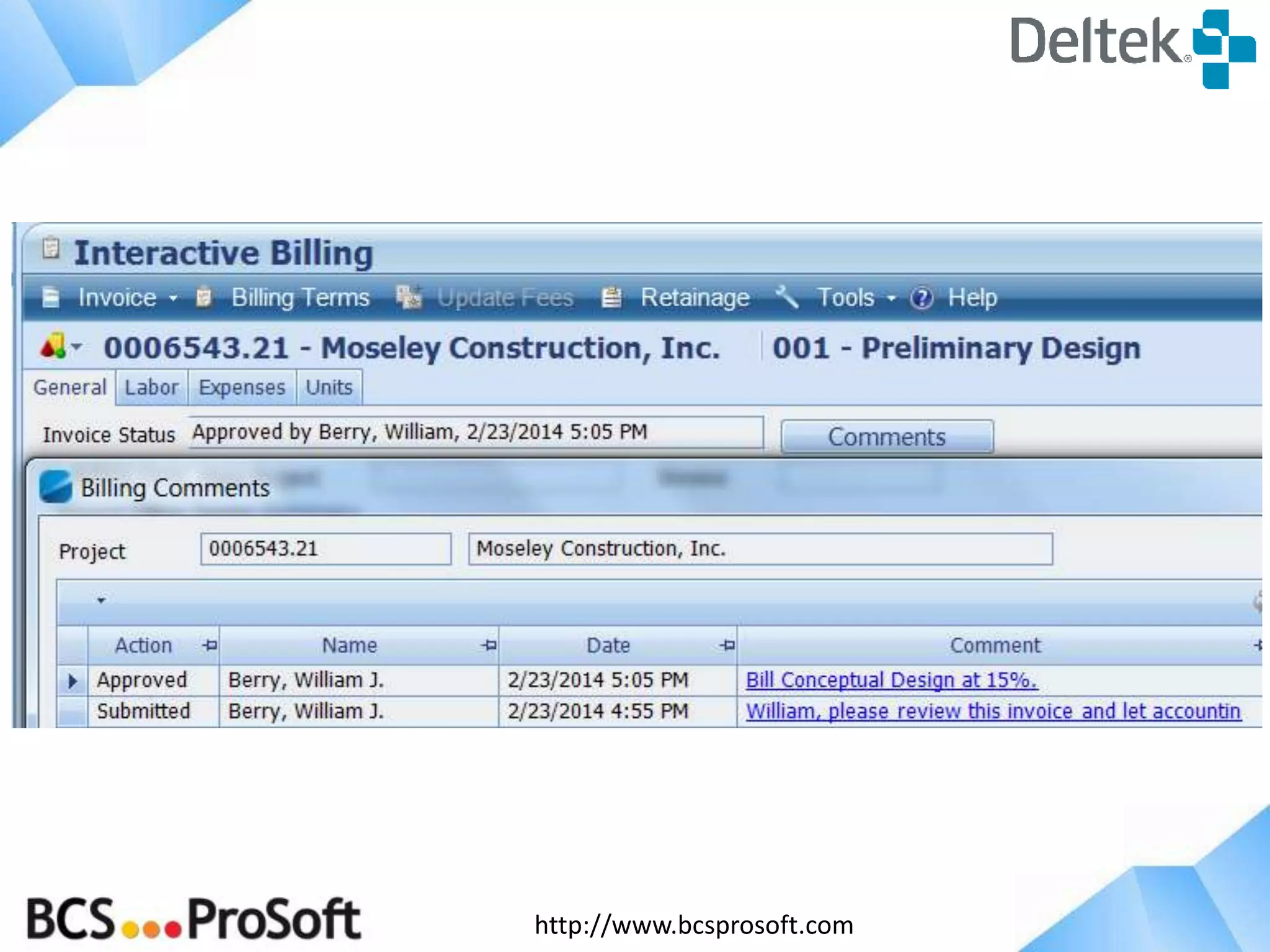

Where is the Biller Assigned?
New Biller Field
http://www.bcsprosoft.com

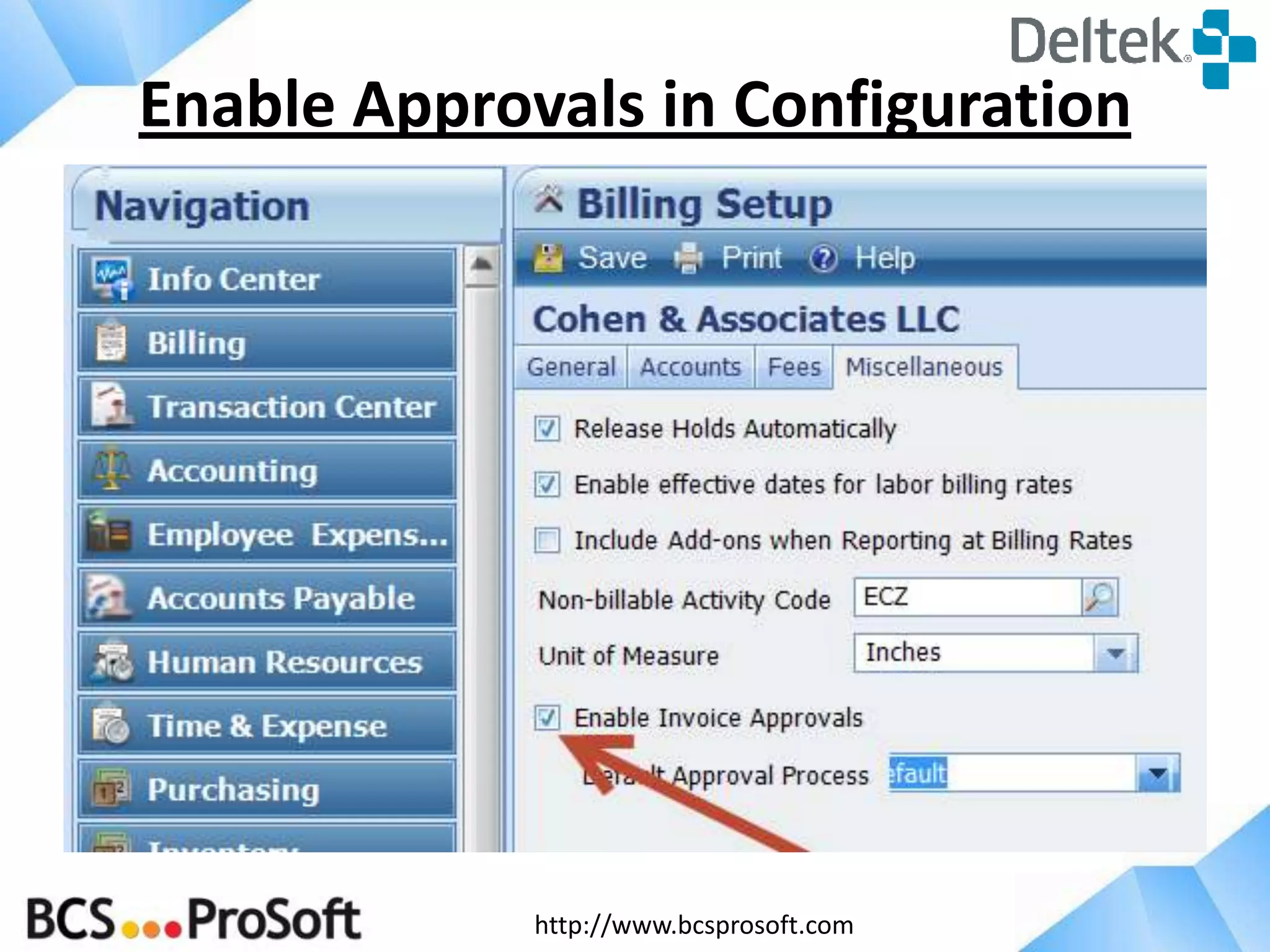

Enable Approvals in Configuration
http://www.bcsprosoft.com

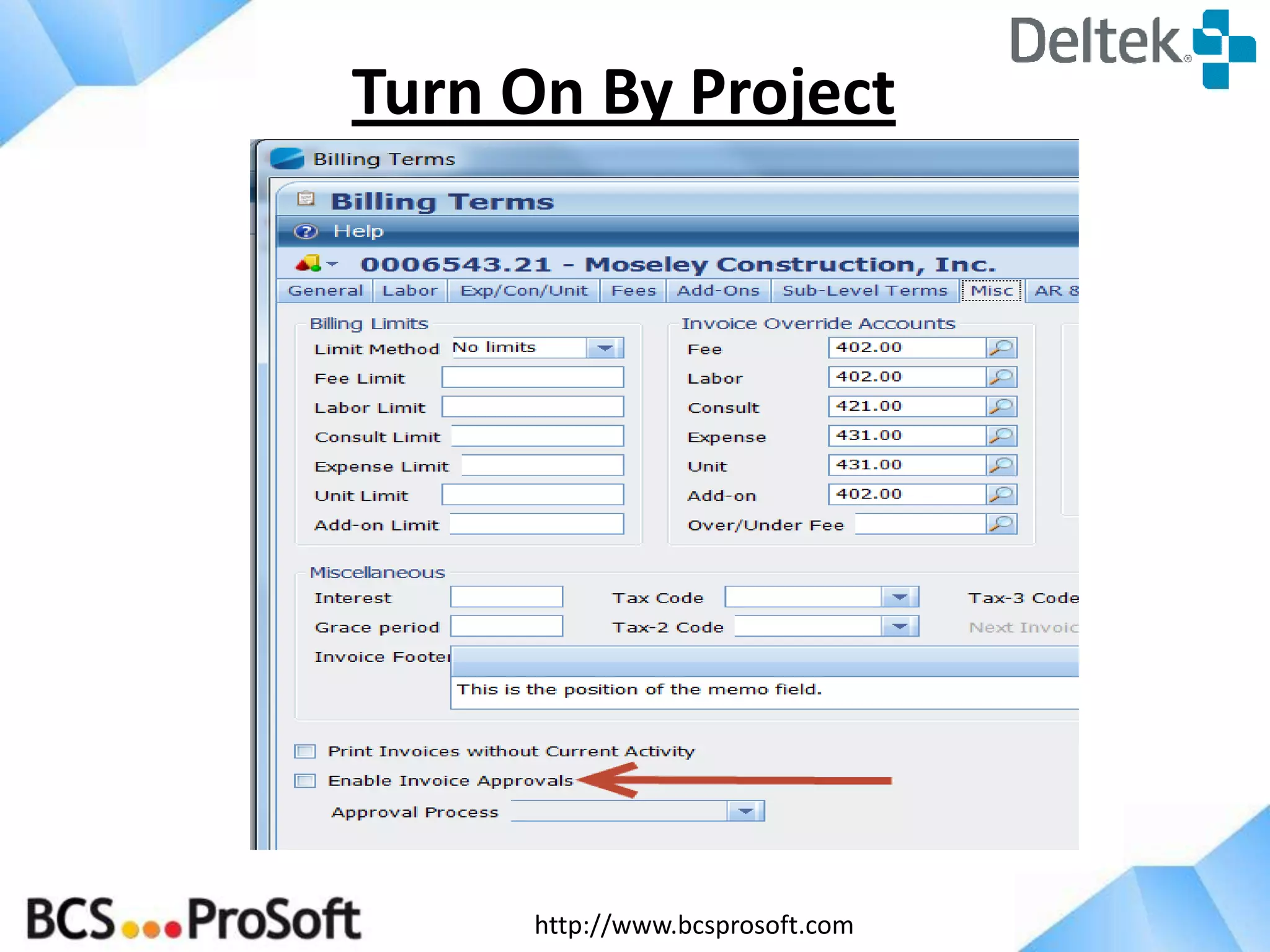

Turn On By Project
http://www.bcsprosoft.com

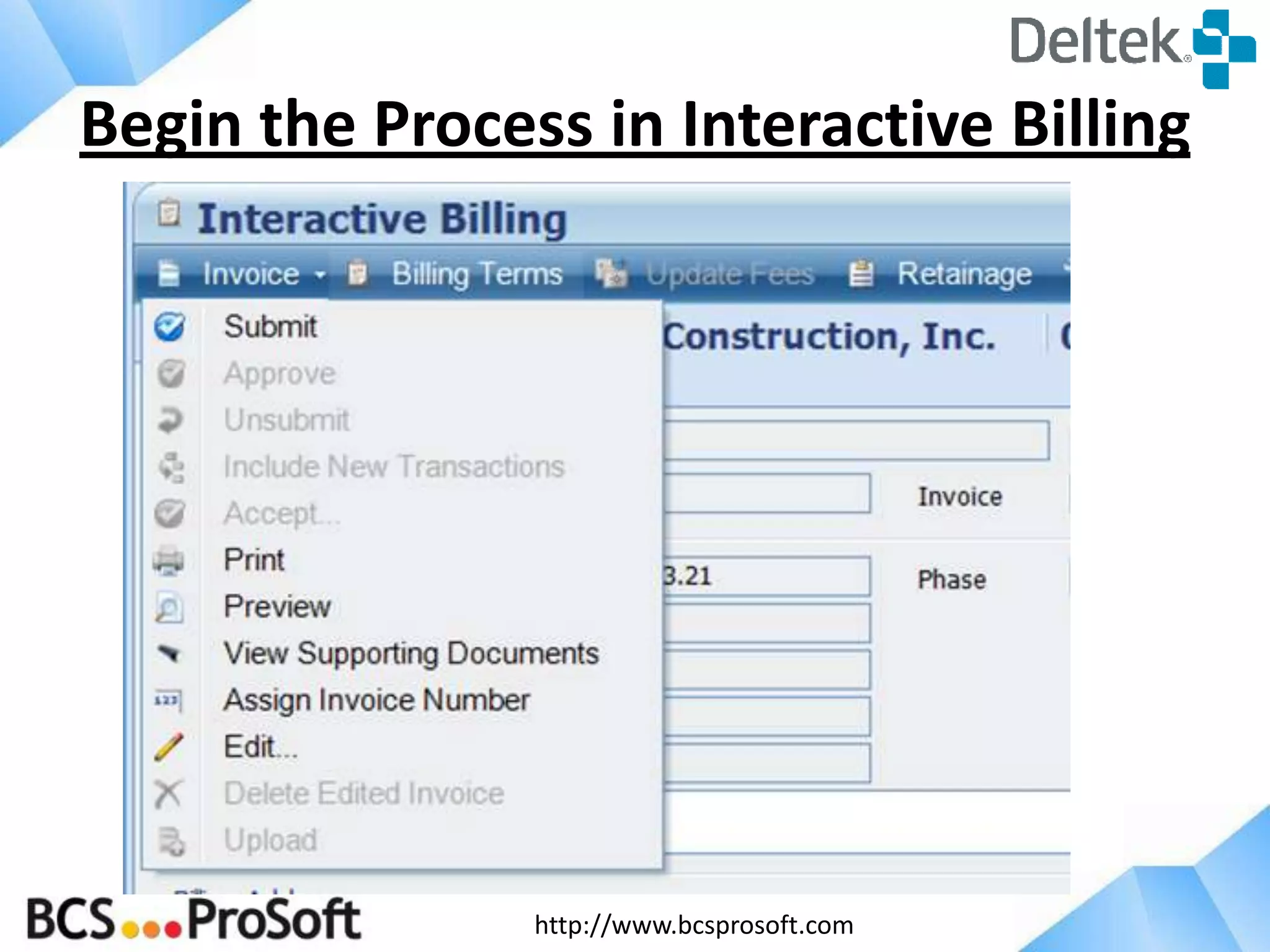

Begin the Process in Interactive Billing
http://www.bcsprosoft.com

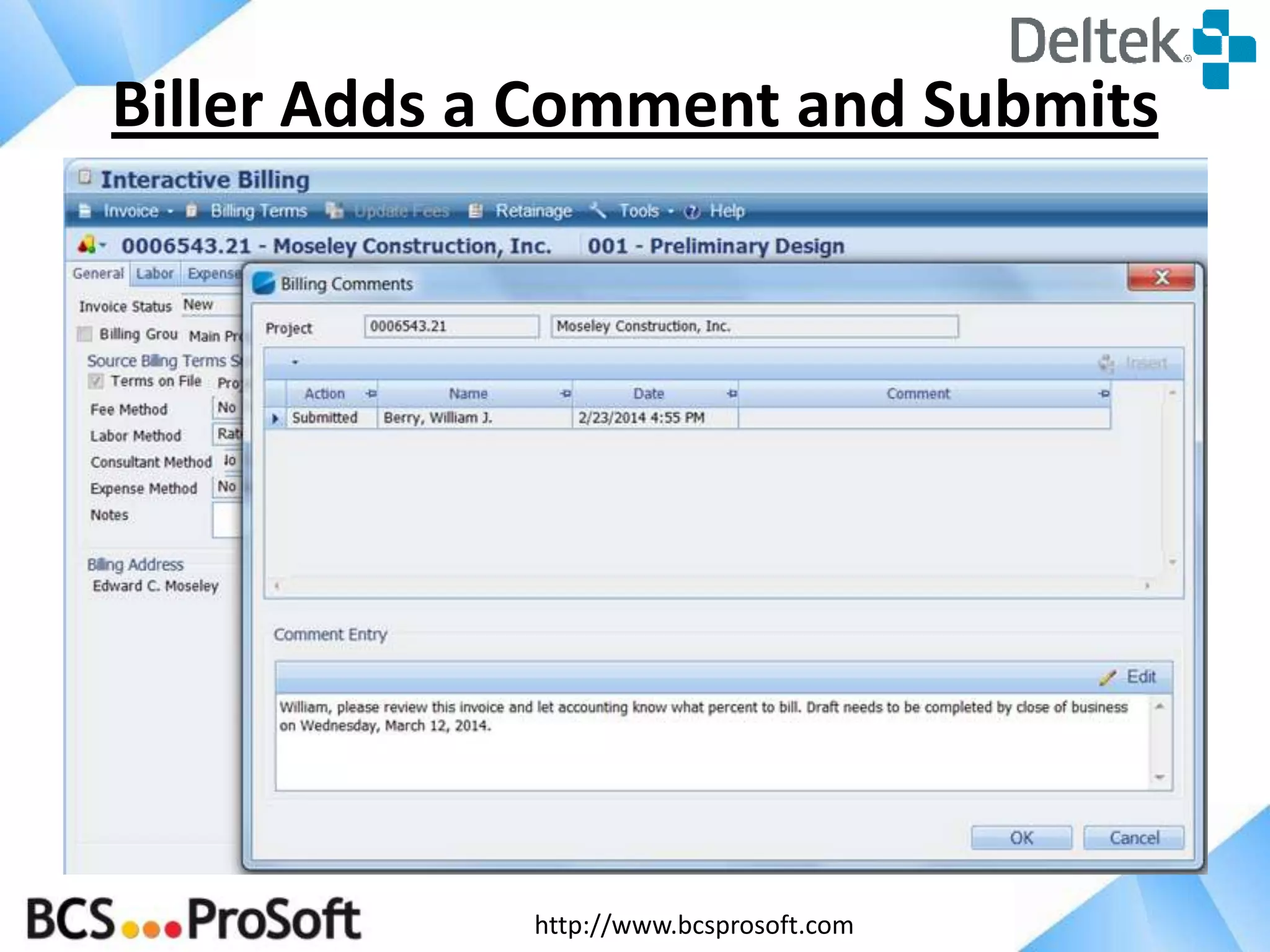

Biller Adds a Comment and Submits
http://www.bcsprosoft.com
• Preview – the Draft Invoice
• Comments
• Update Fees – if turned on in Security
• View Details
• Approve
• Reject

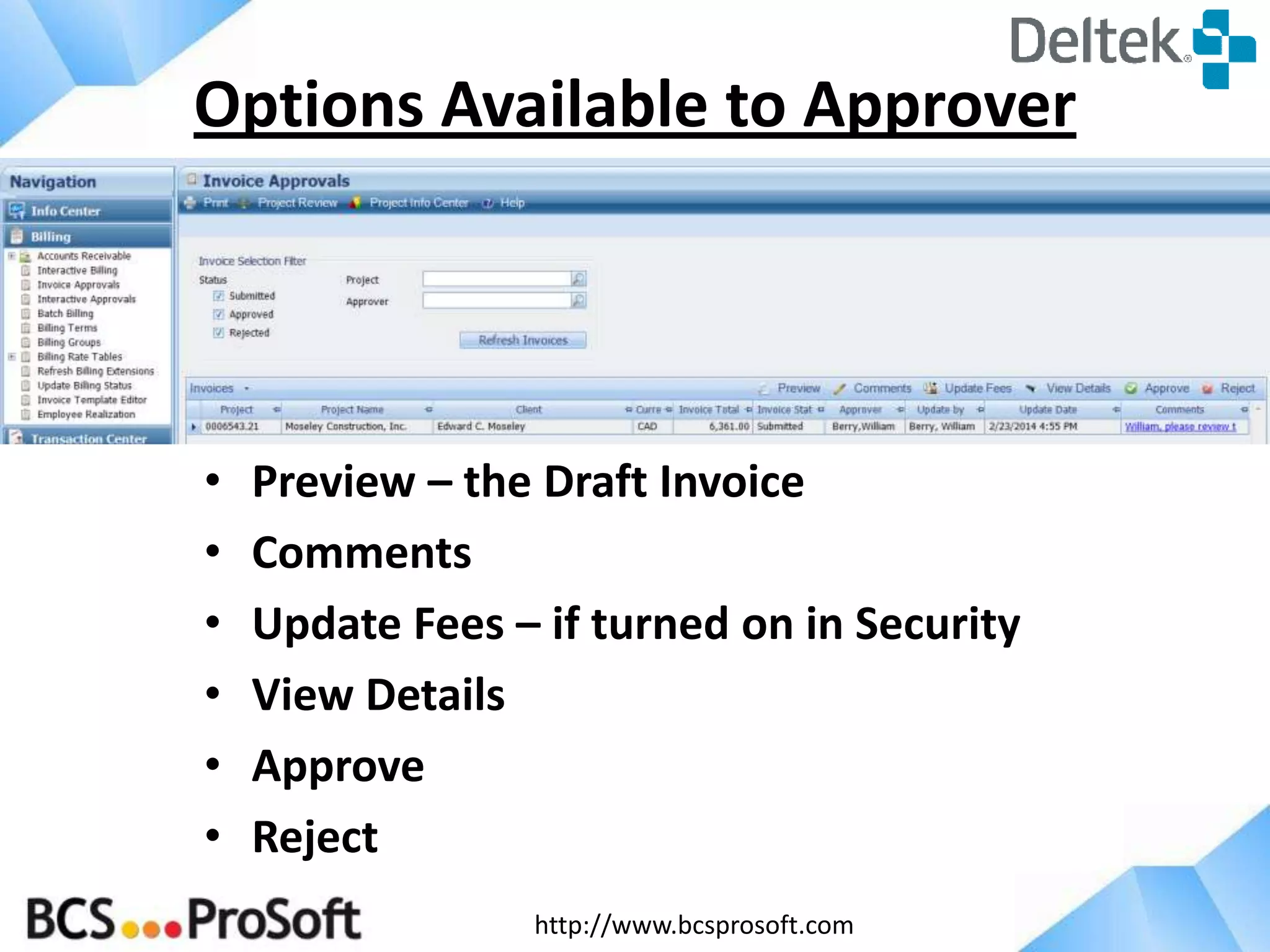

Options Available to Approver
http://www.bcsprosoft.com

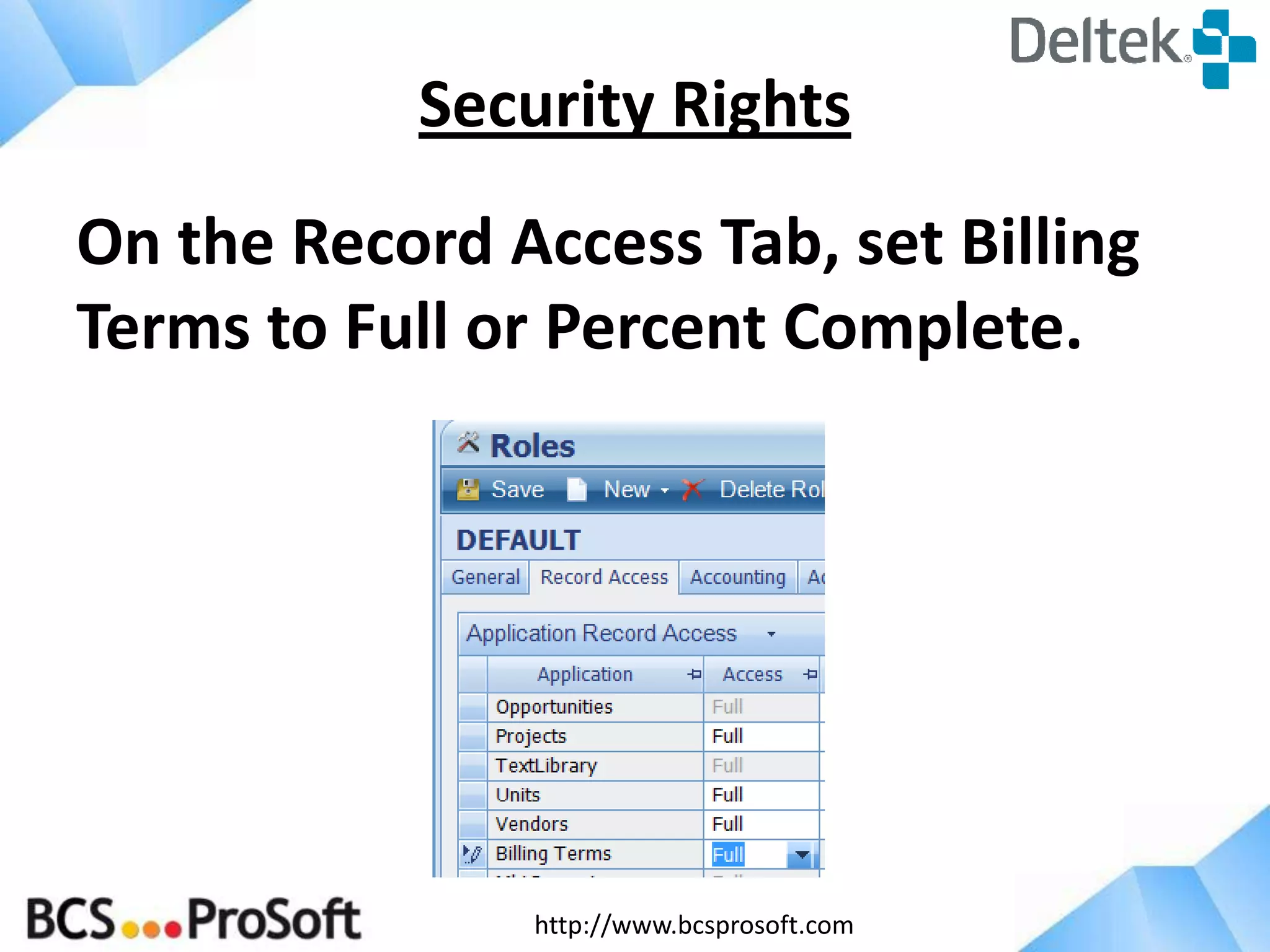

On the Record Access Tab, set Billing
Terms to Full or Percent Complete.
Security Rights
http://www.bcsprosoft.com
http://www.bcsprosoft.com

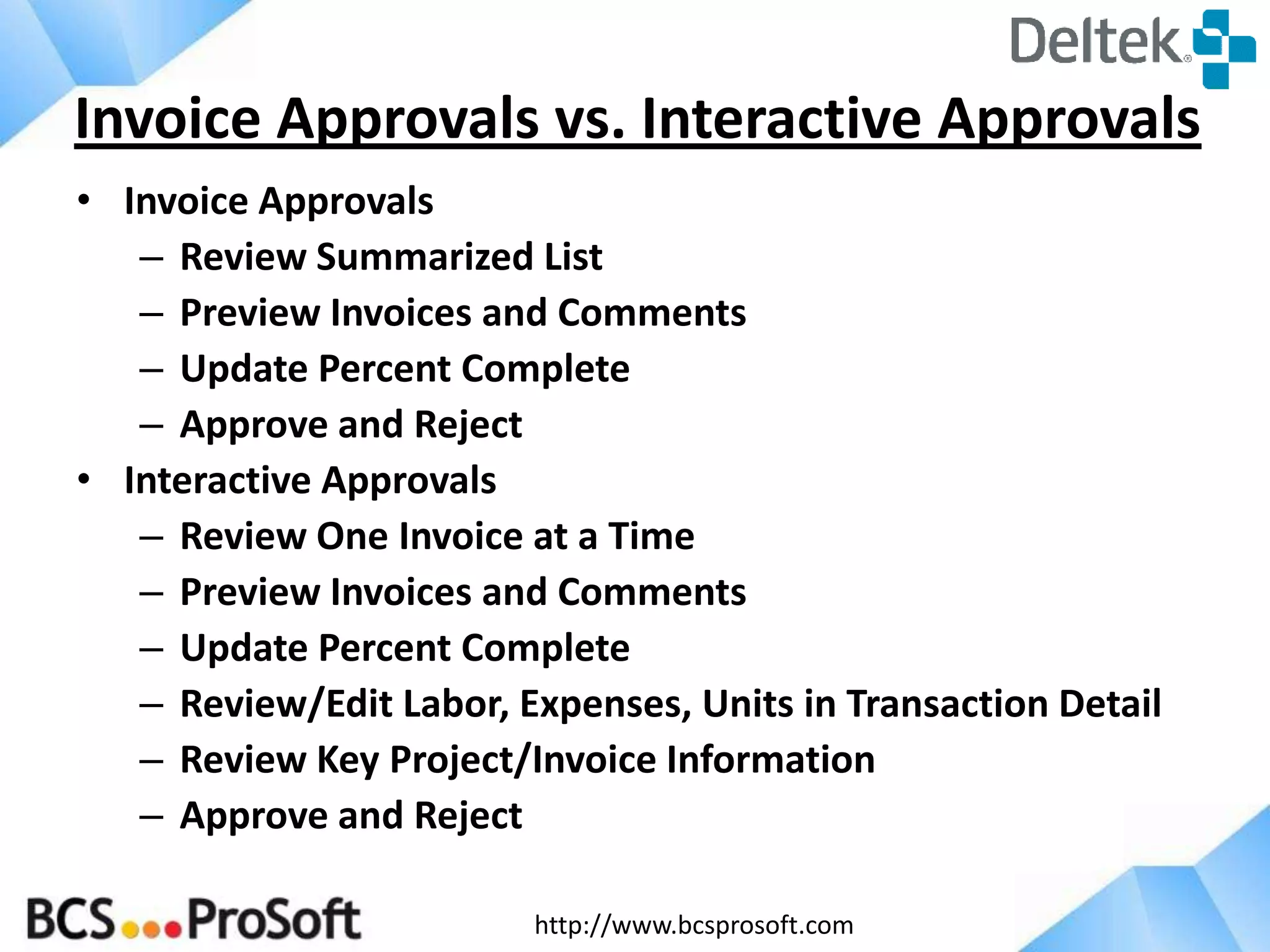

• Invoice Approvals
– Review Summarized List
– Preview Invoices and Comments
– Update Percent Complete
– Approve and Reject
• Interactive Approvals
– Review One Invoice at a Time
– Preview Invoices and Comments
– Update Percent Complete
– Review/Edit Labor, Expenses, Units in Transaction Detail
– Review Key Project/Invoice Information
– Approve and Reject
Invoice Approvals vs. Interactive Approvals
http://www.bcsprosoft.com

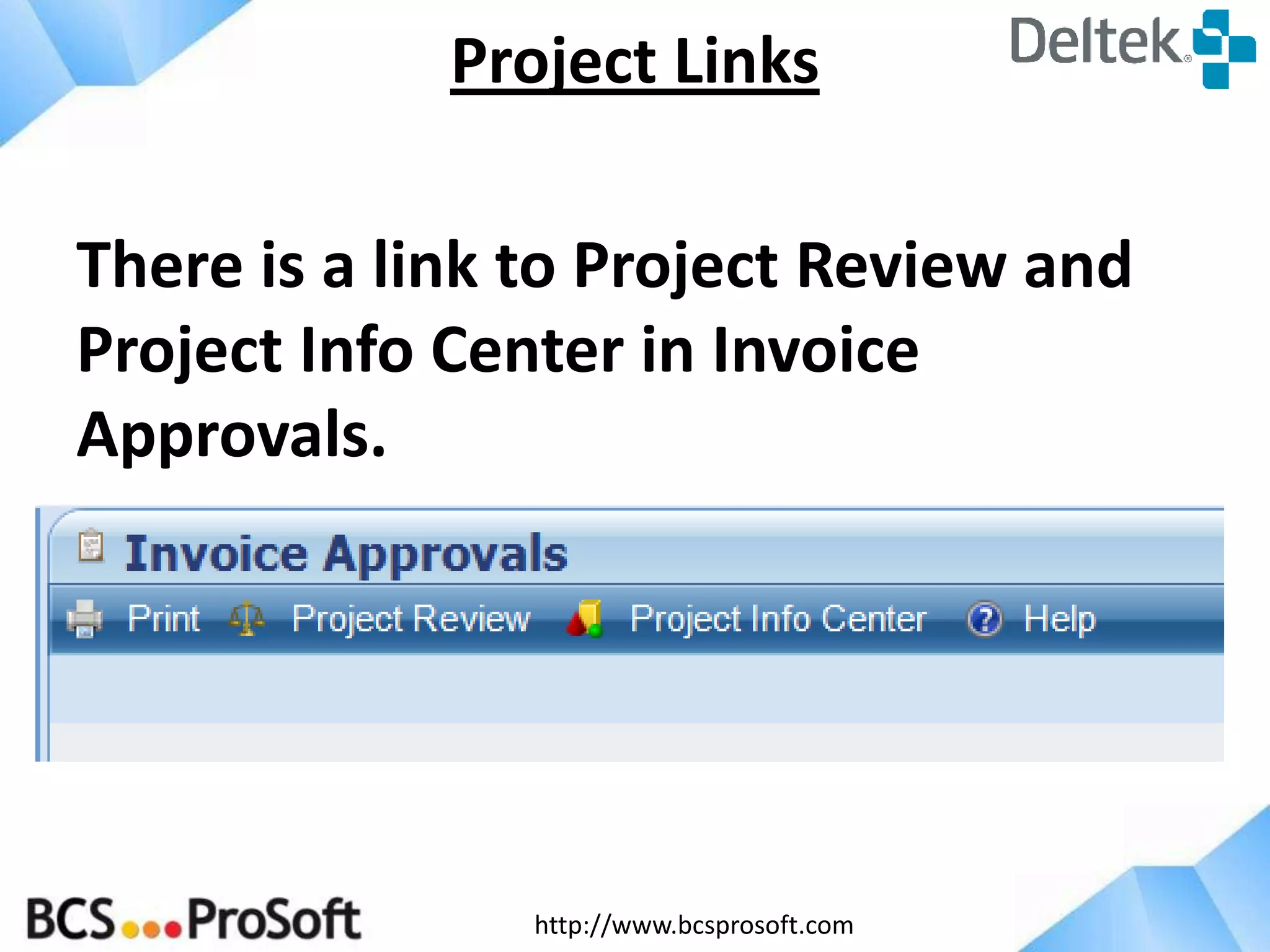

There is a link to Project Review and
Project Info Center in Invoice
Approvals.
Project Links
http://www.bcsprosoft.com

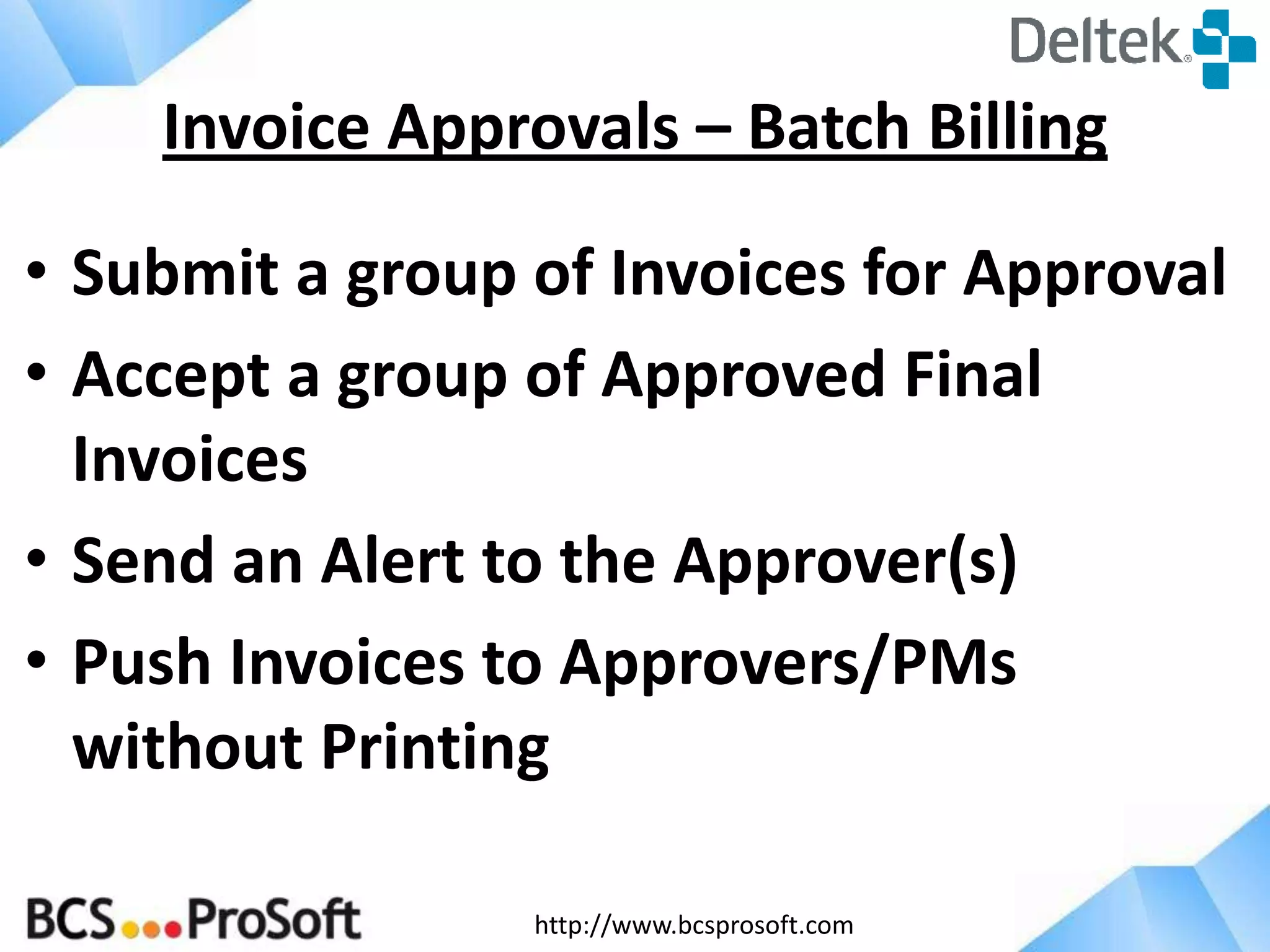

• Submit a group of Invoices for Approval
• Accept a group of Approved Final
Invoices
• Send an Alert to the Approver(s)
• Push Invoices to Approvers/PMs
without Printing
Invoice Approvals – Batch Billing
http://www.bcsprosoft.com

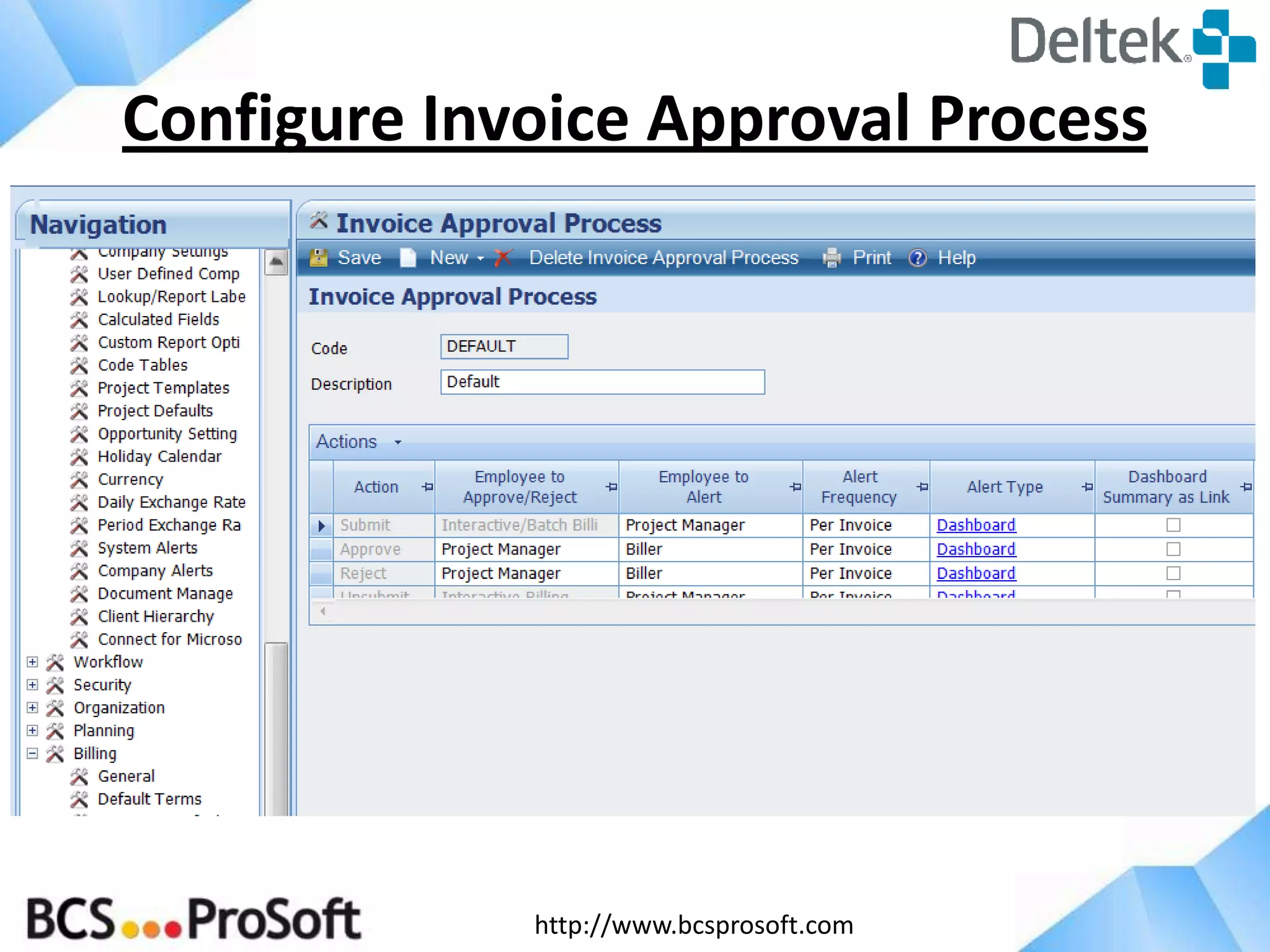

Configure Invoice Approval Process
http://www.bcsprosoft.com

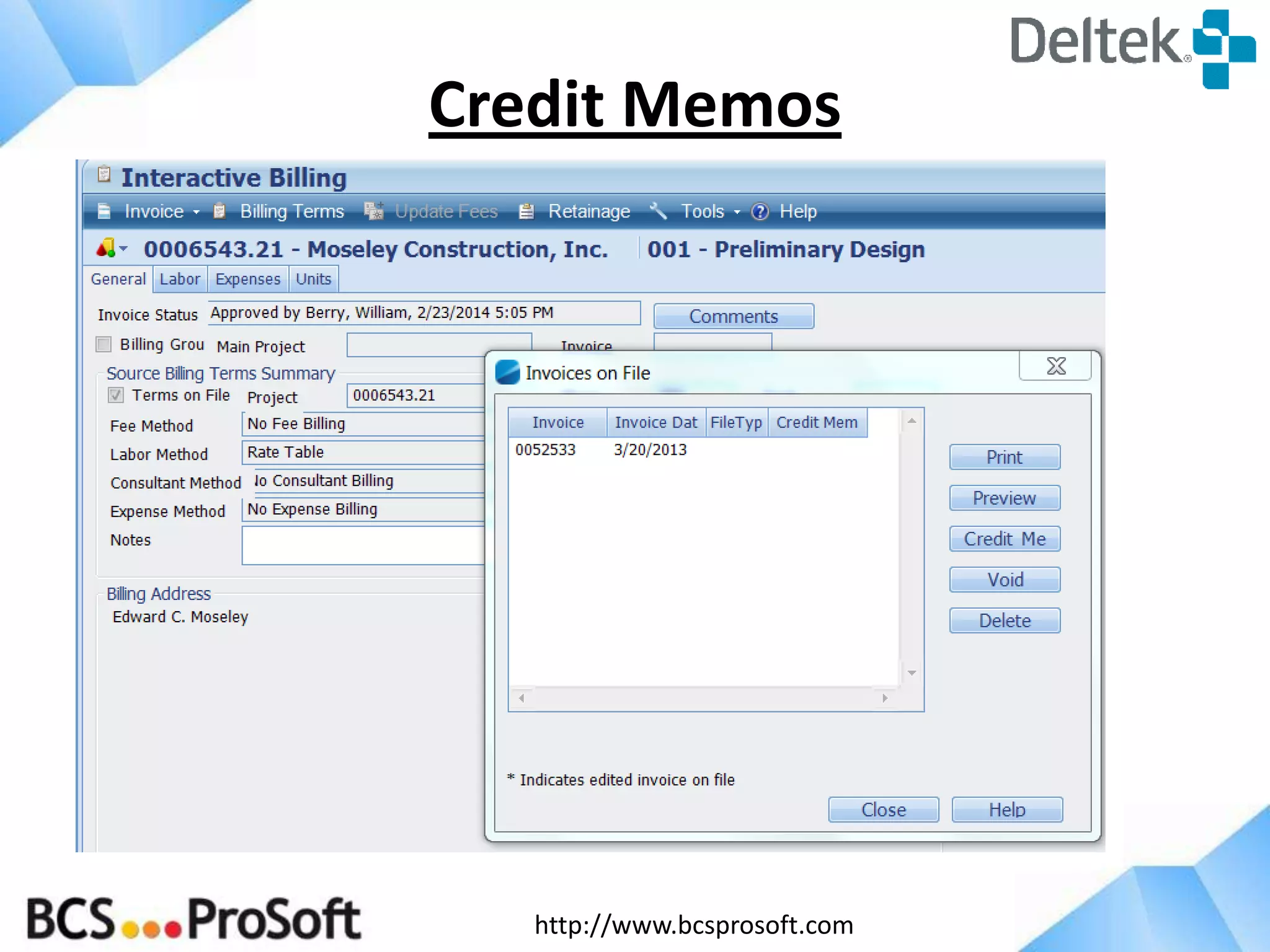

Credit Memos

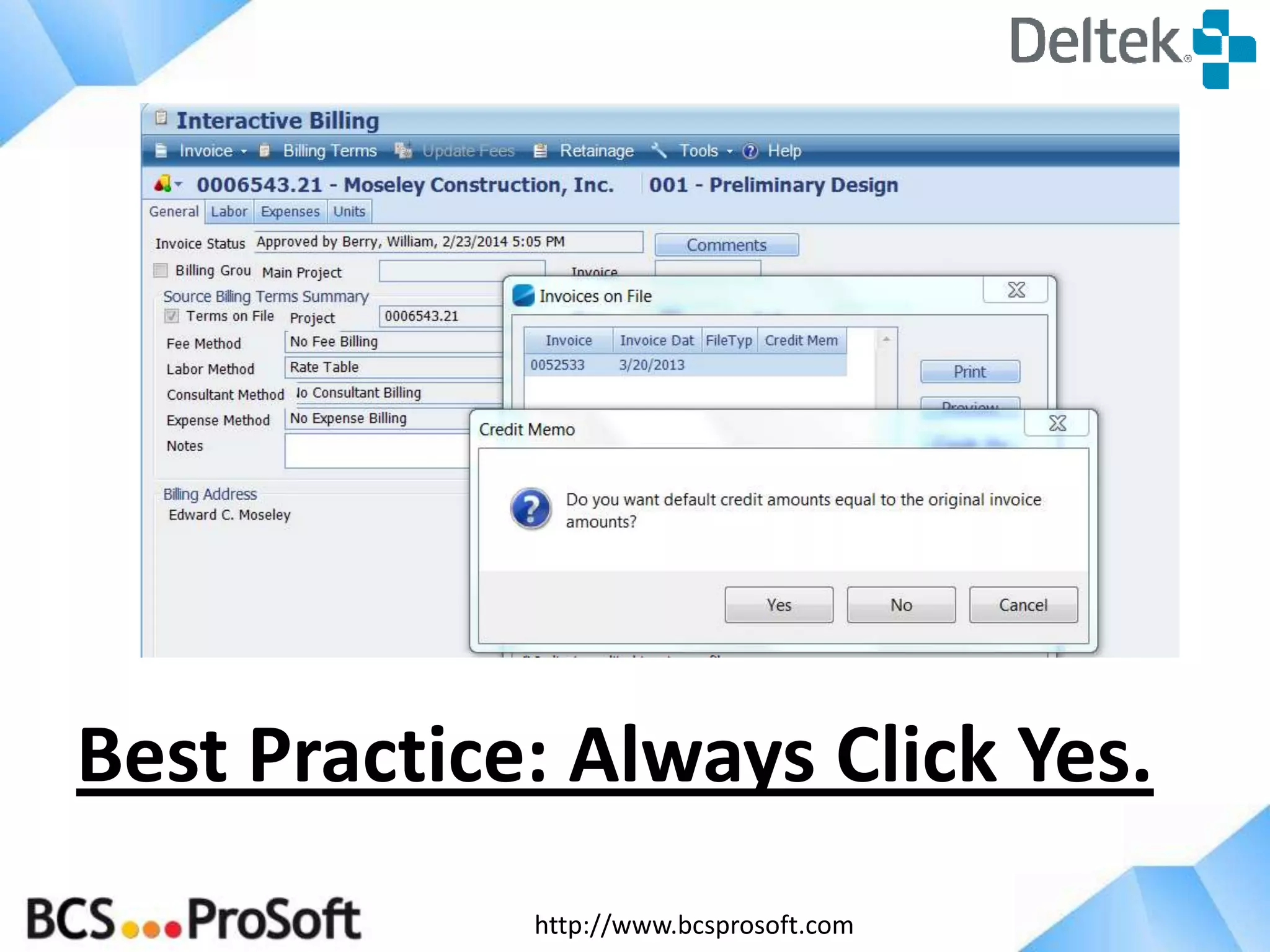

http://www.bcsprosoft.com
Best Practice: Always Click Yes.
http://www.bcsprosoft.com

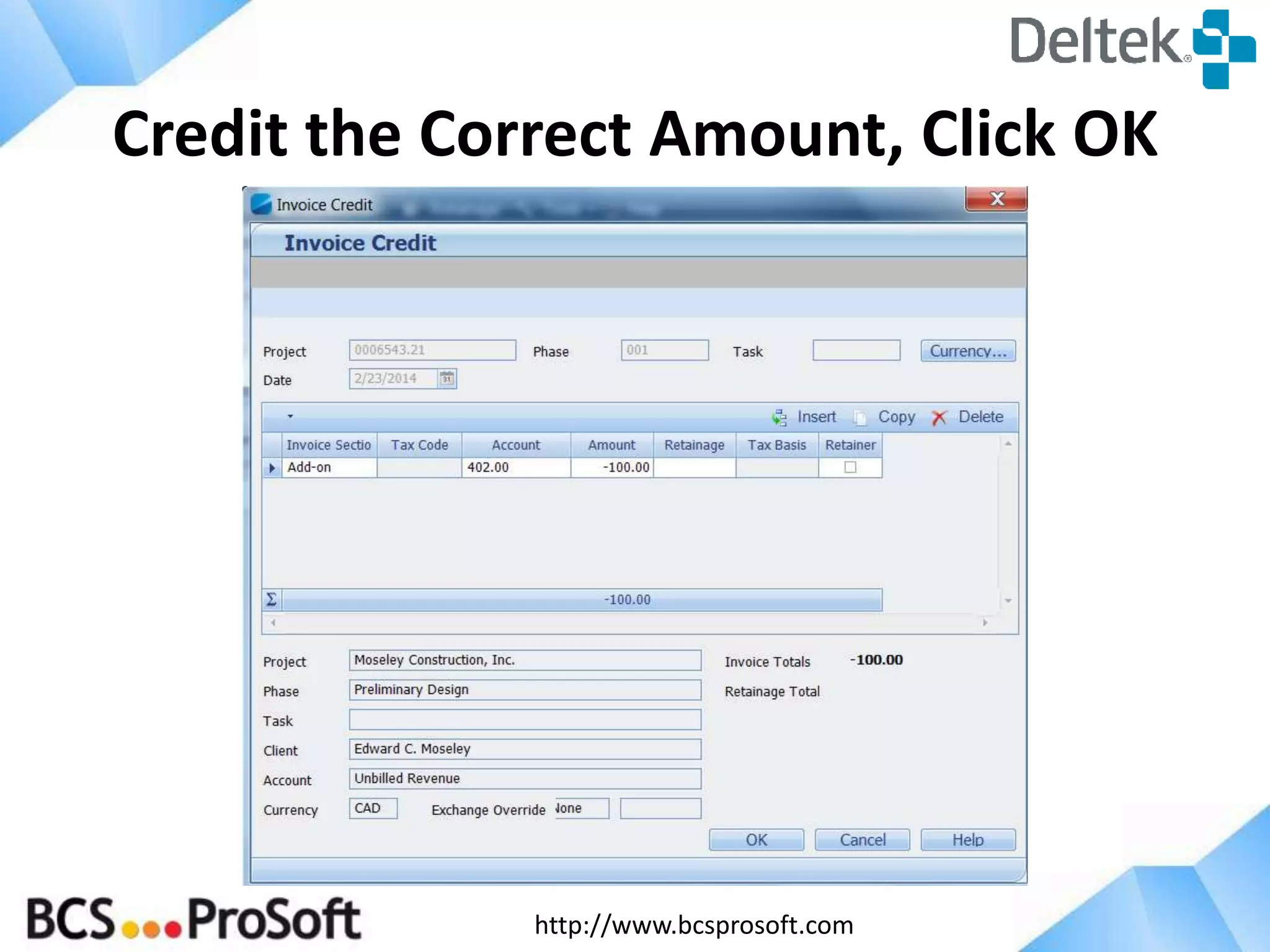

Credit the Correct Amount, Click OK
http://www.bcsprosoft.com

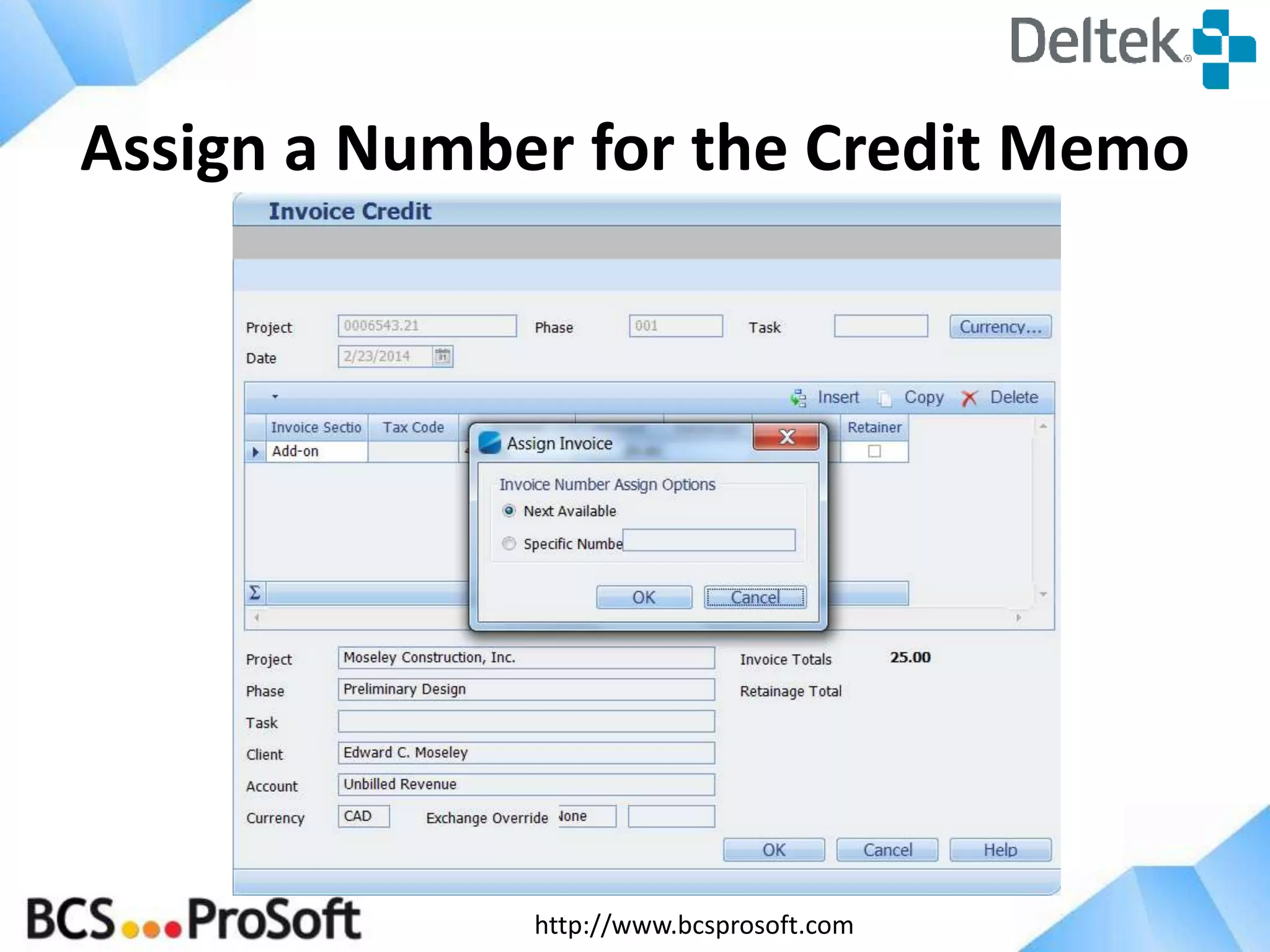

Assign a Number for the Credit Memo
http://www.bcsprosoft.com

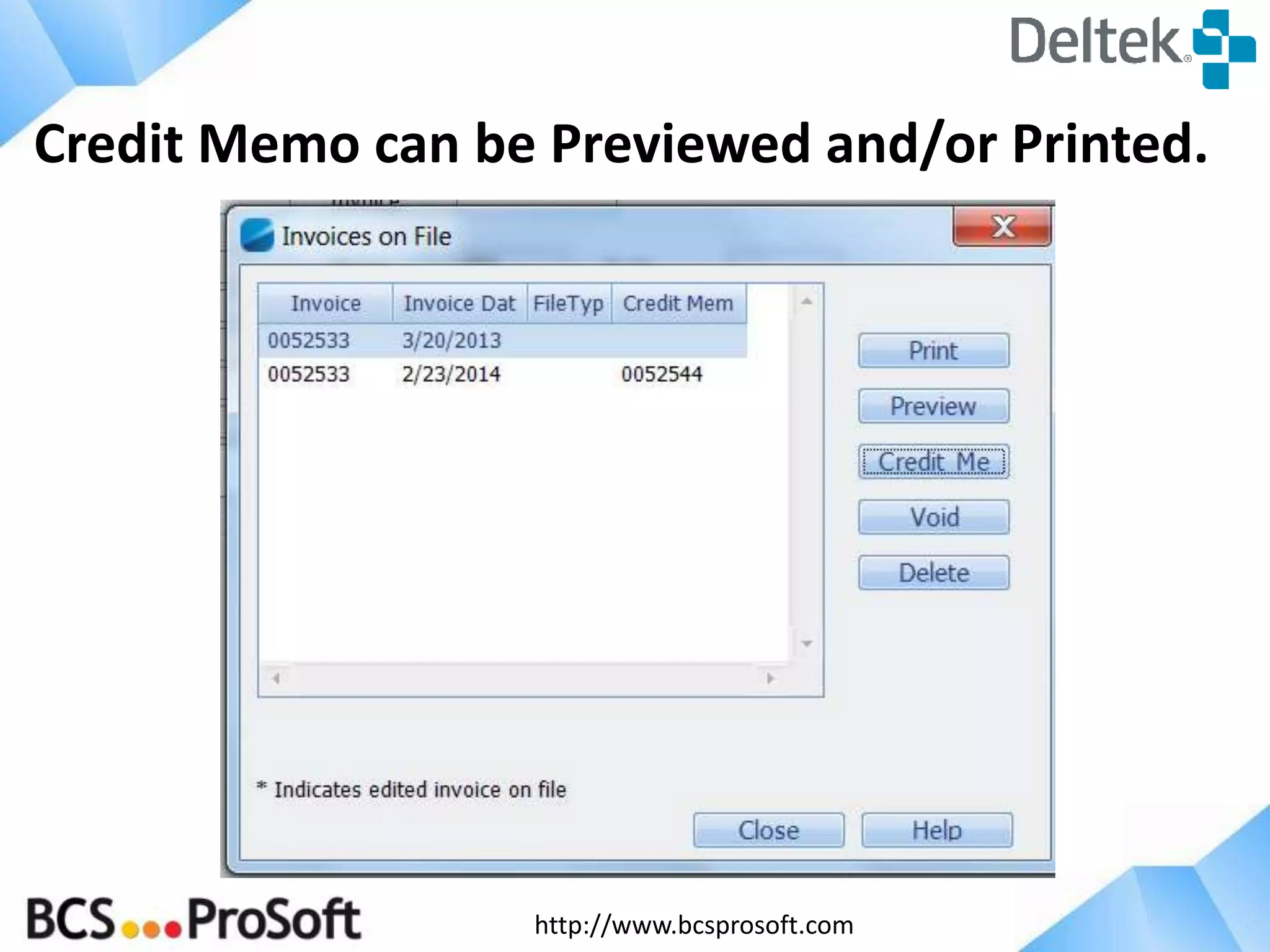

Credit Memo can be Previewed and/or Printed.
http://www.bcsprosoft.com

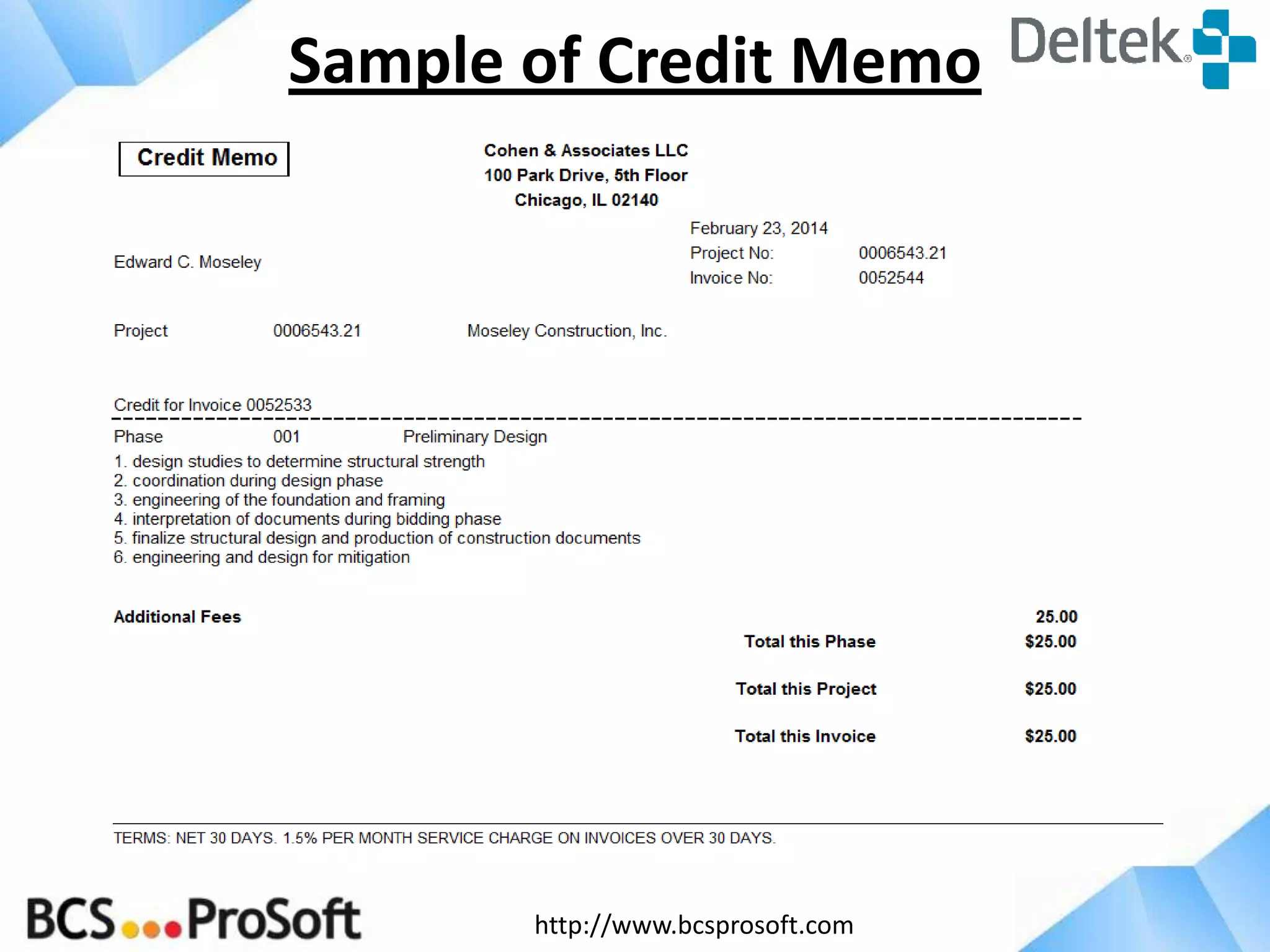

Sample of Credit Memo
http://www.bcsprosoft.com

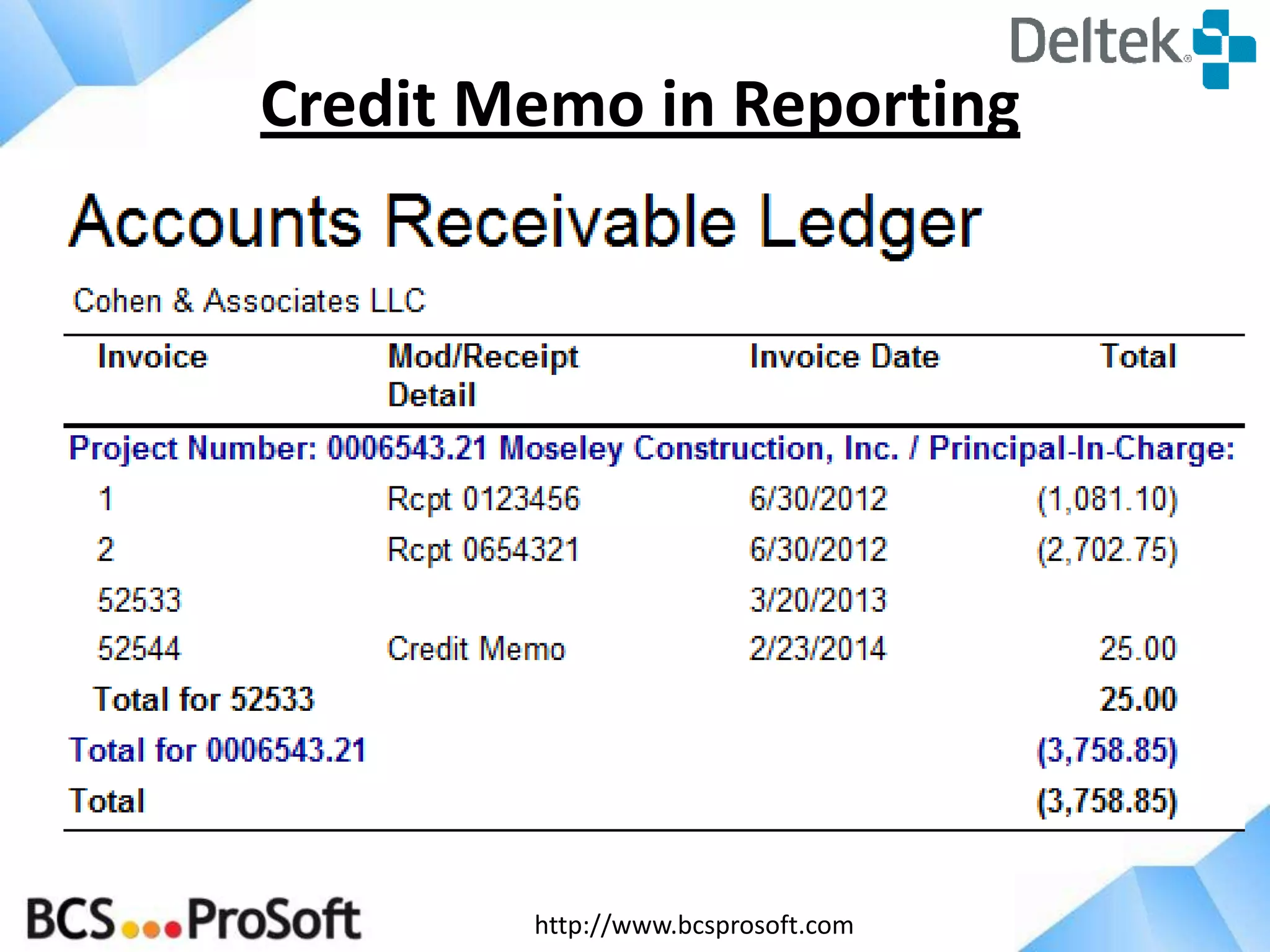

Credit Memo in Reporting
http://www.bcsprosoft.com

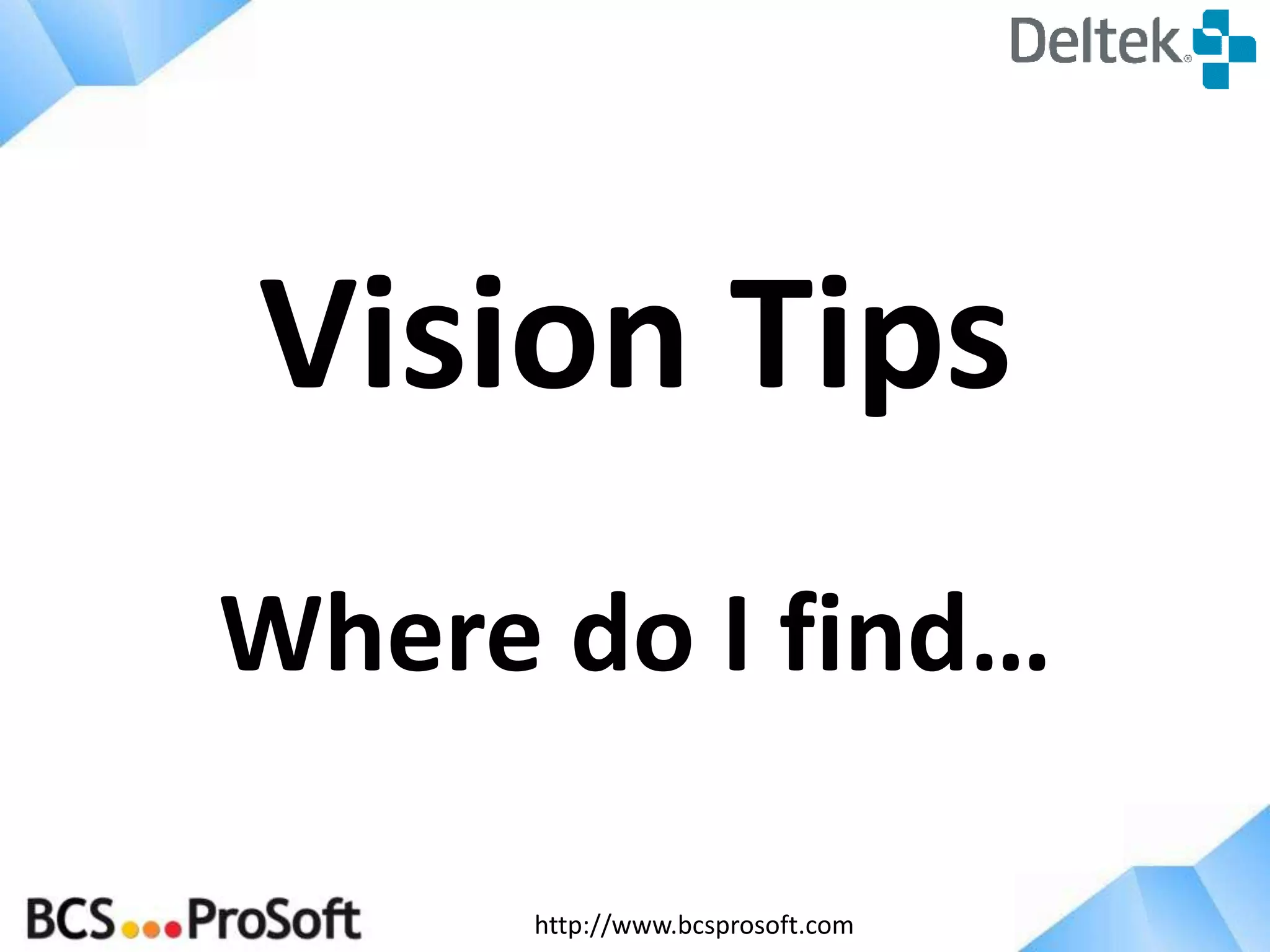

Vision Tips
Where do I find…
http://www.bcsprosoft.com
Where to find…
Reporting by Employee Realization

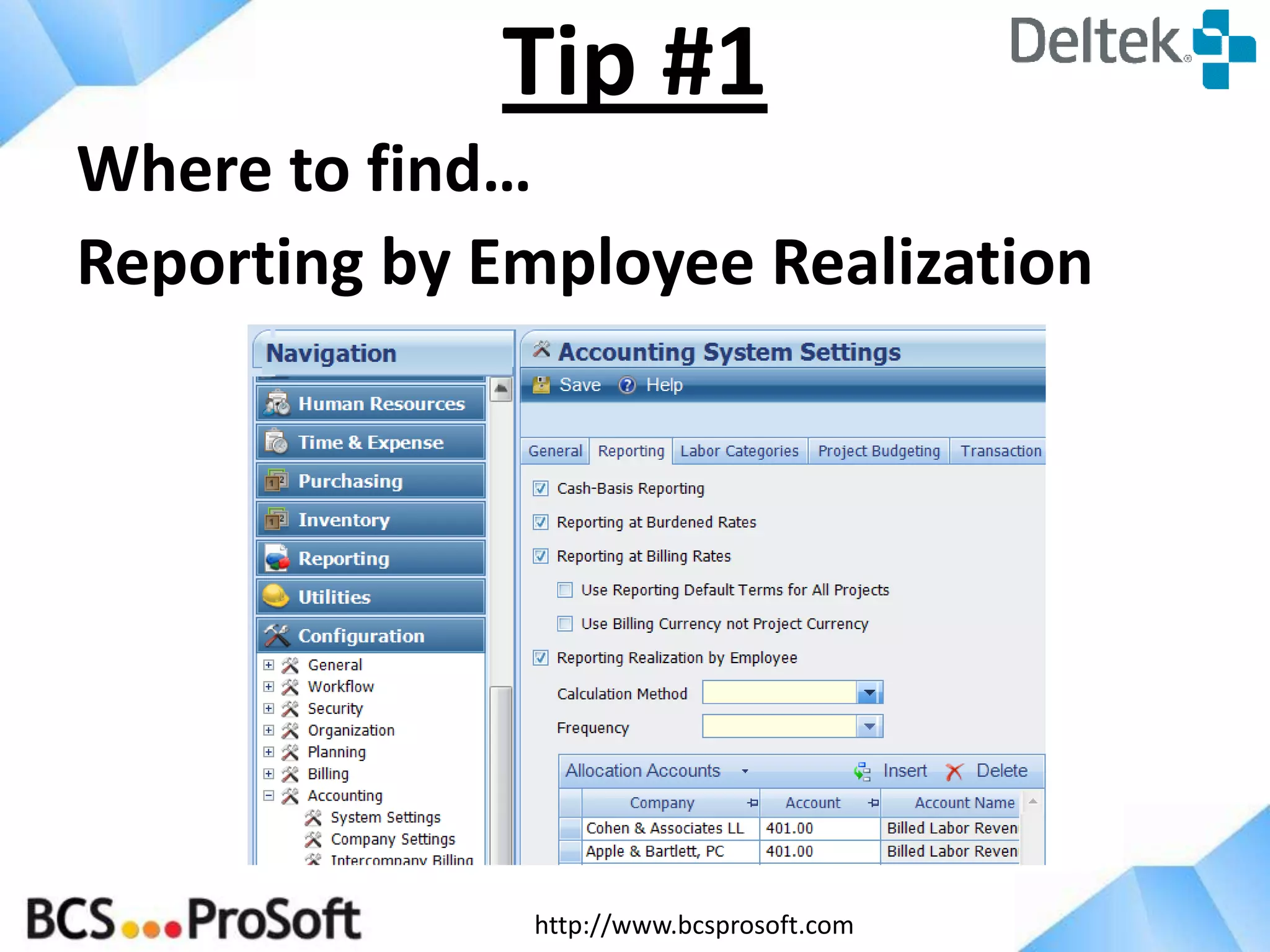

Tip #1
http://www.bcsprosoft.com

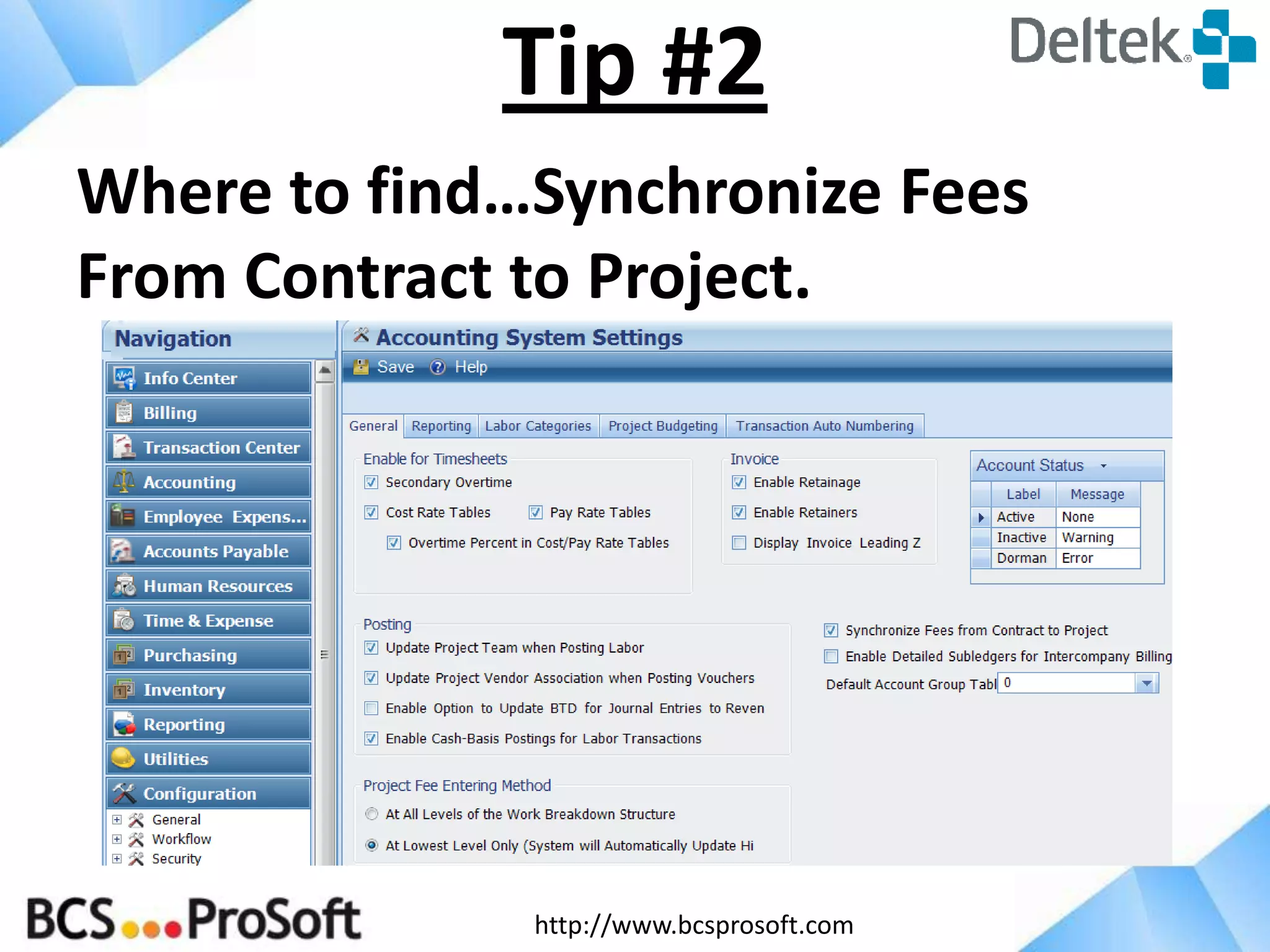

Where to find…Synchronize Fees
From Contract to Project.
Tip #2
http://www.bcsprosoft.com

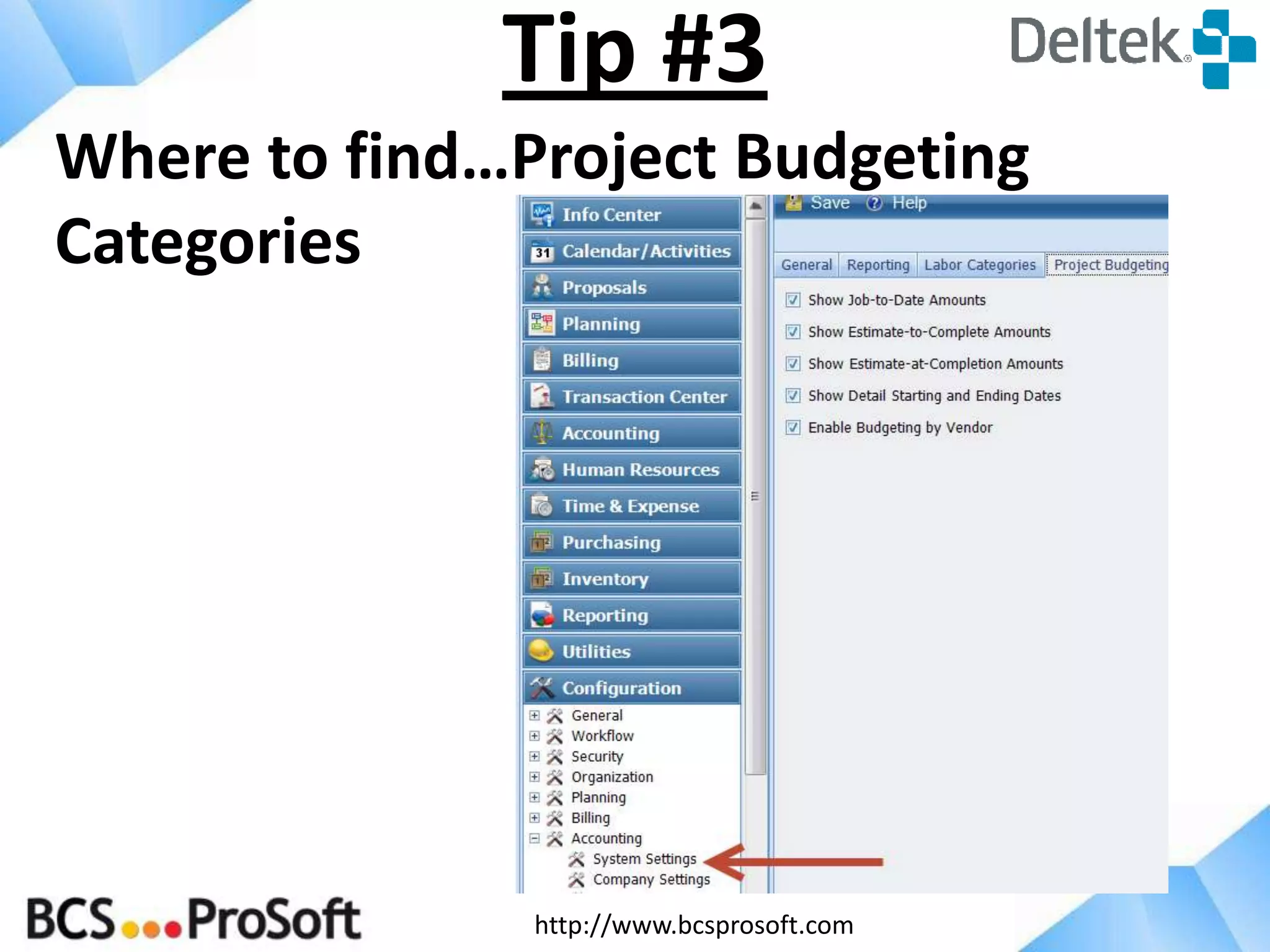

Where to find…Project Budgeting
Categories
Tip #3
http://www.bcsprosoft.com

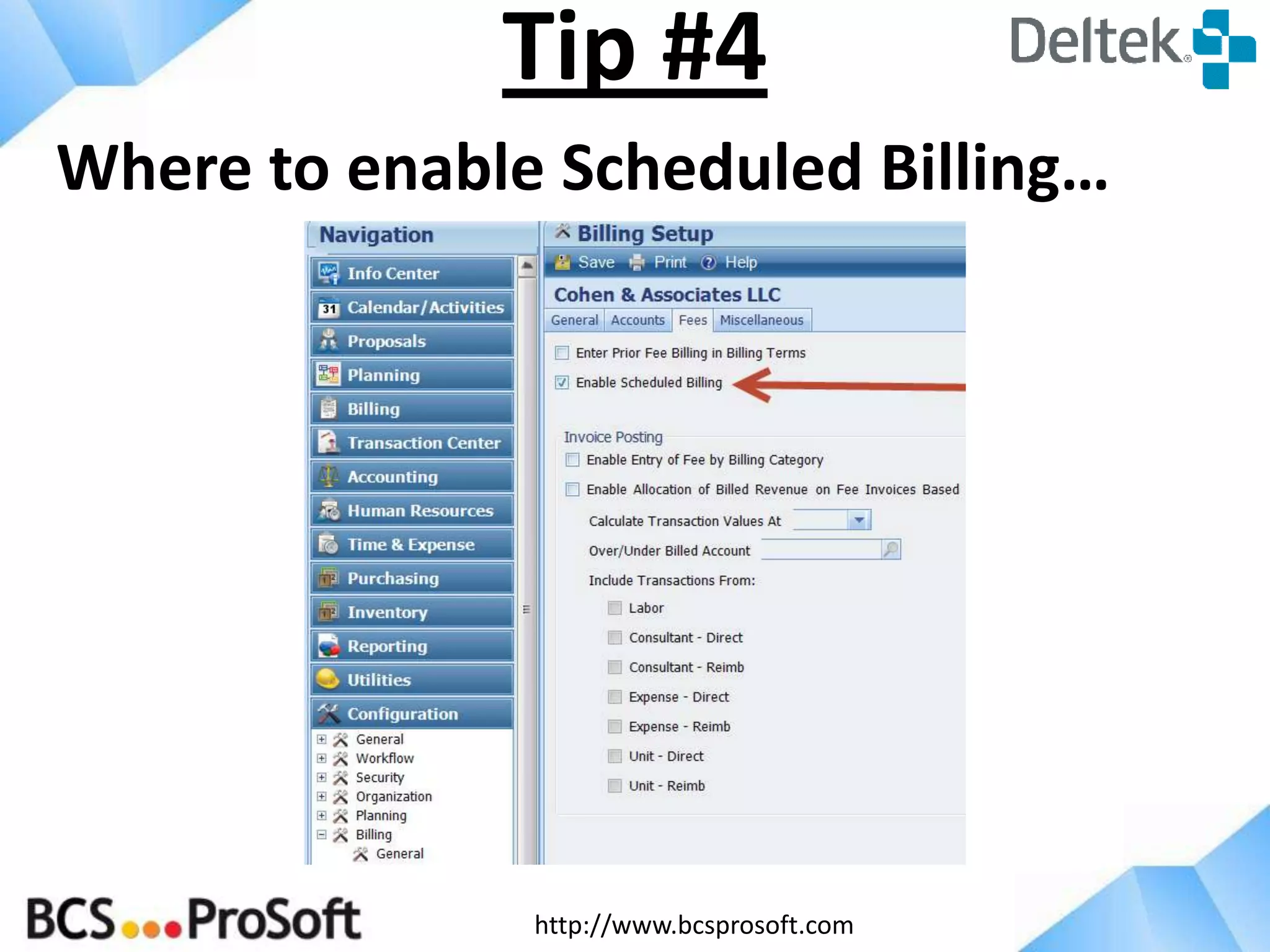

Where to enable Scheduled Billing…
Tip #4
http://www.bcsprosoft.com
Version 7.2 has expanded options for calculating
the Rate Method on a project (project info
center/budget and revenue tab).

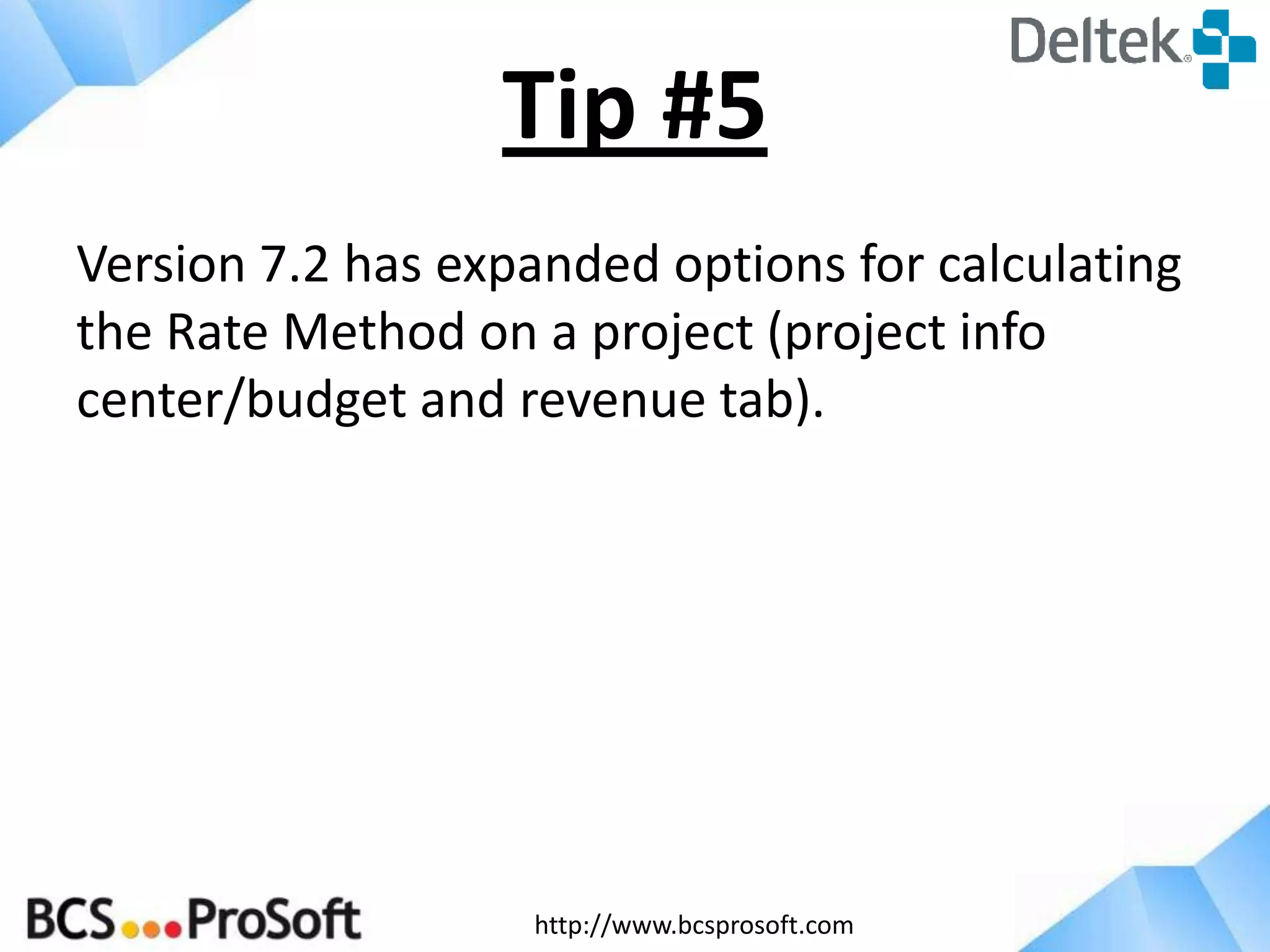

Tip #5
http://www.bcsprosoft.com

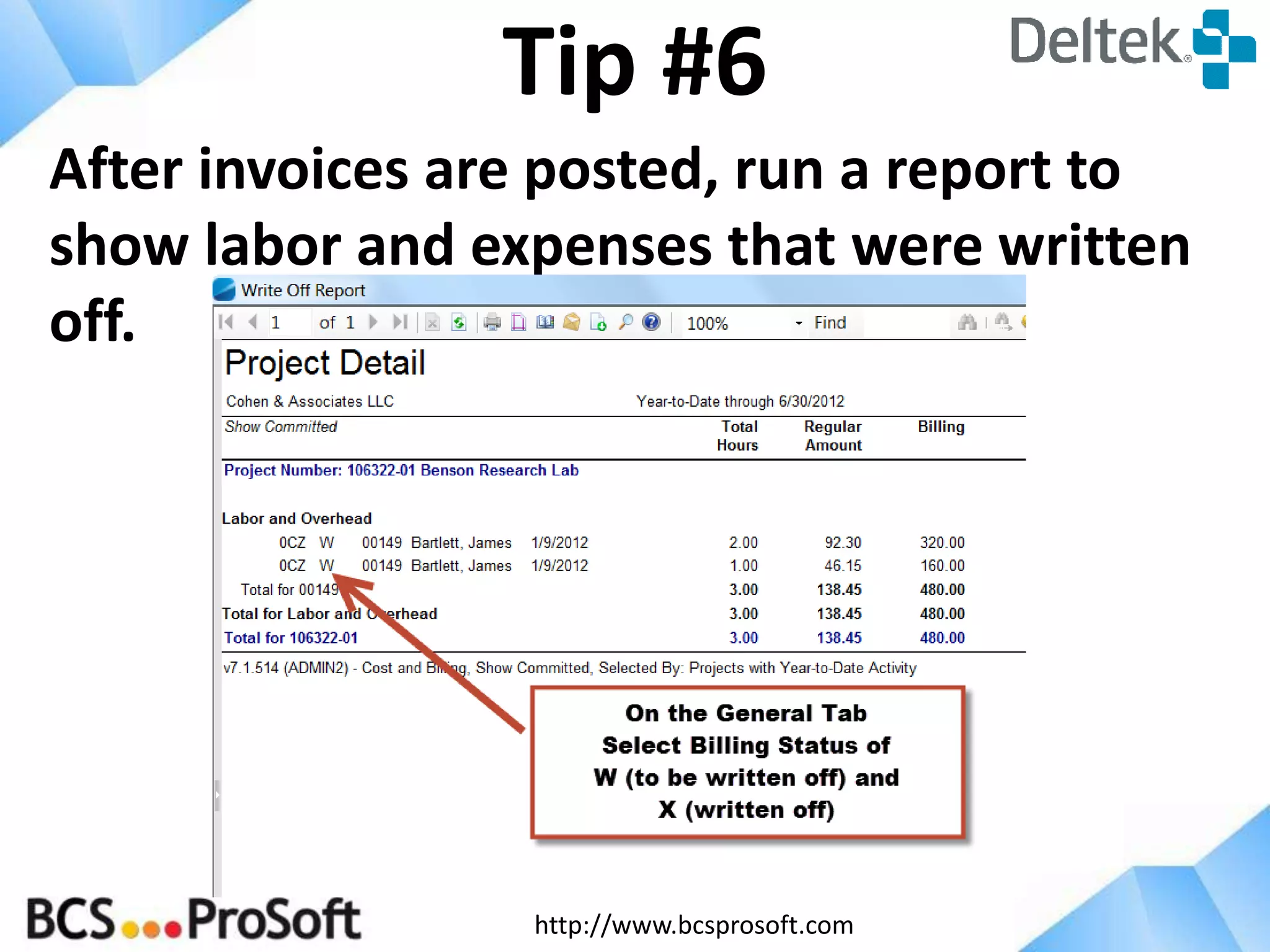

After invoices are posted, run a report to
show labor and expenses that were written
off.
Tip #6
http://www.bcsprosoft.com

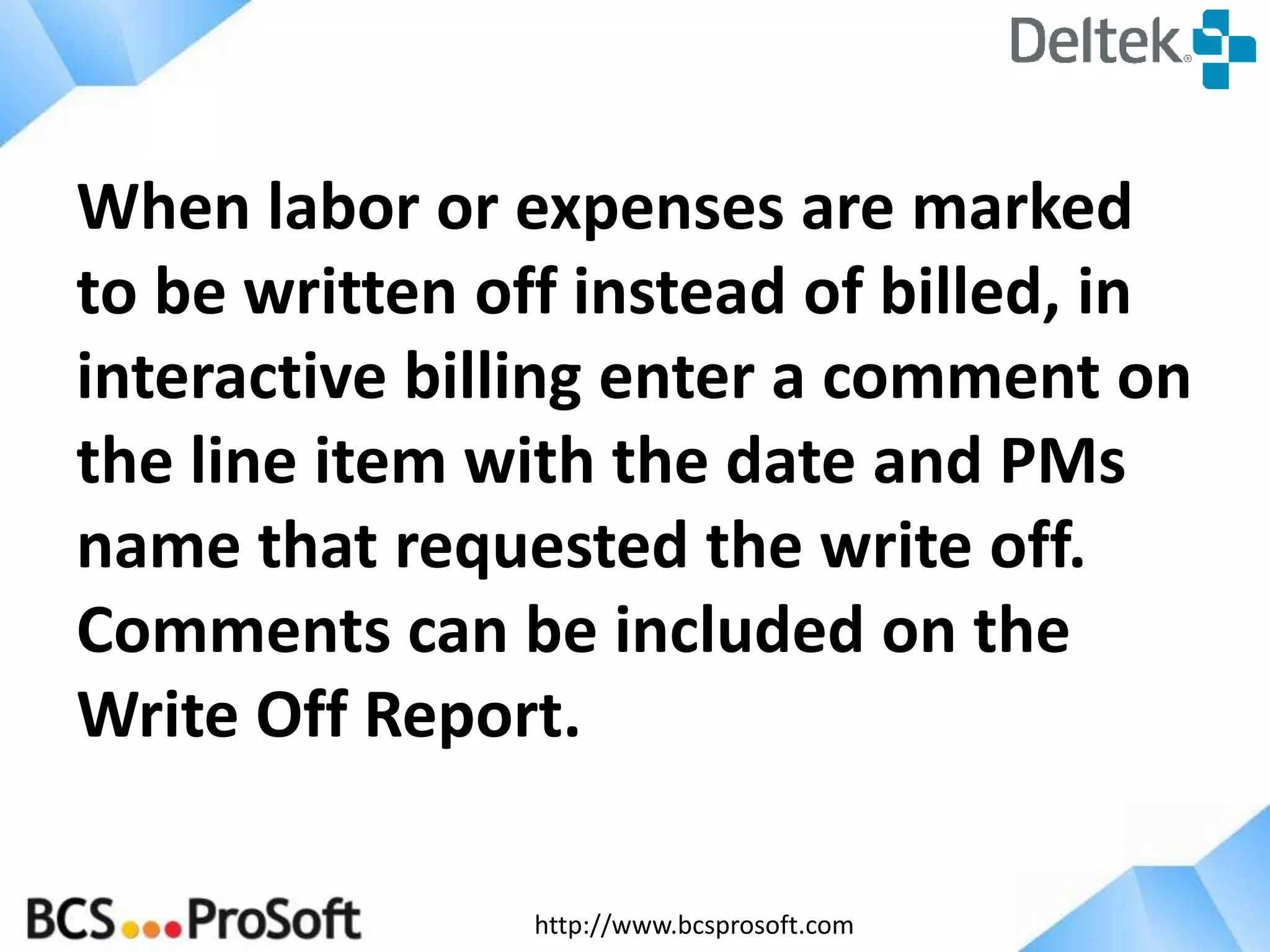

When labor or expenses are marked
to be written off instead of billed, in
interactive billing enter a comment on
the line item with the date and PMs
name that requested the write off.
Comments can be included on the
Write Off Report.
http://www.bcsprosoft.com
Hawaii June 12, 2014
San Antonio June 17, 2014
Houston June 18, 2014
Next Users Group Meetings
