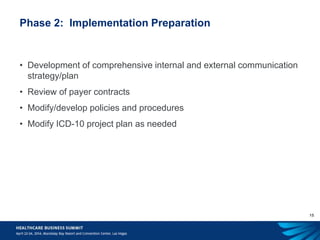

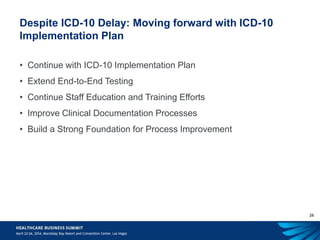

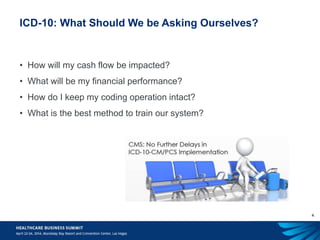

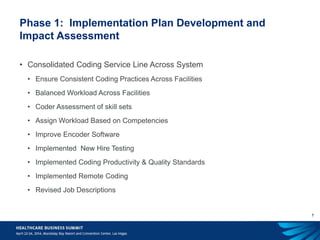

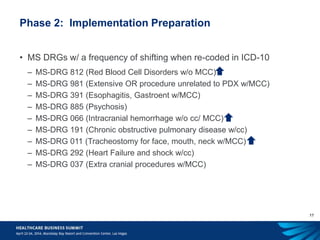

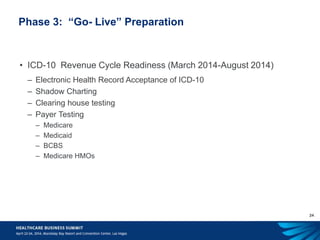

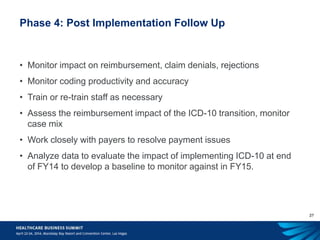

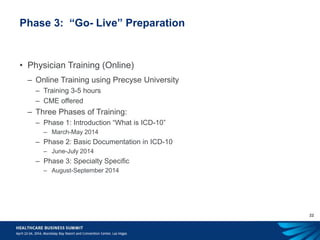

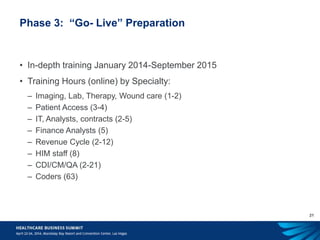

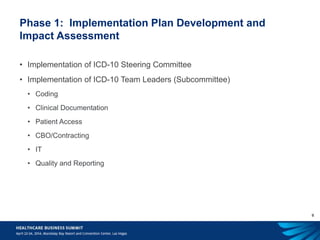

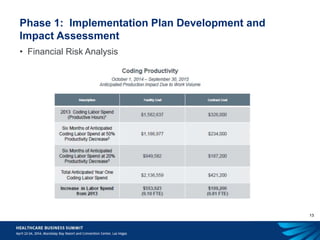

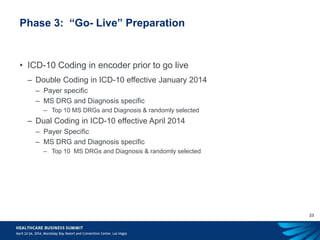

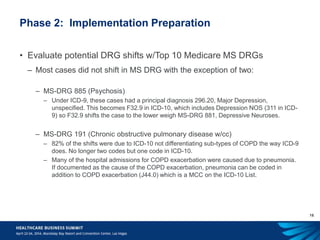

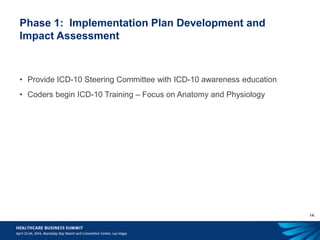

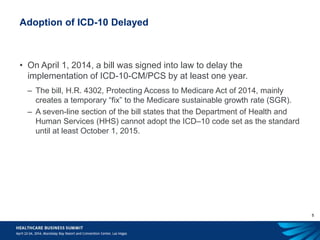

The document outlines Baptist Health System's multi-phase approach to implementing ICD-10 across their health system. Phase 1 involved developing an implementation plan and assessing impacts. Phase 2 was preparation, including training, testing, and financial analysis. Phase 3 was "go-live" preparation with extensive training, testing, and ensuring systems were ready. Phase 4 involves post-implementation follow up. Despite the ICD-10 delay, Baptist Health is continuing forward with their implementation plan to be prepared. Effective communication is emphasized as key to the process.
