“THE ROAD TO EXCESS”
SANRAL’S HIGH COST OF ROAD CONSTRUCTION IN SOUTH AFRICA
& THE OVERPAYMENT OF ALMOST R10BN ON GAUTENG’S FREEWAY UPGRADE

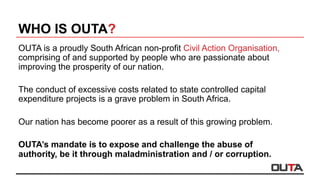

WHO IS OUTA?
OUTA is a proudly South African non-profit Civil Action Organisation,
comprising of and supported by people who are passionate about
improving the prosperity of our nation.
The conduct of excessive costs related to state controlled capital
expenditure projects is a grave problem in South Africa.
Our nation has become poorer as a result of this growing problem.
OUTA’s mandate is to expose and challenge the abuse of
authority, be it through maladministration and / or corruption.

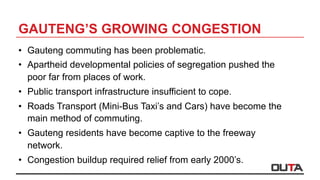

GAUTENG’S GROWING CONGESTION
•  Gauteng commuting has been problematic.
•  Apartheid developmental policies of segregation pushed the
poor far from places of work.
•  Public transport infrastructure insufficient to cope.
•  Roads Transport (Mini-Bus Taxi’s and Cars) have become the
main method of commuting.
•  Gauteng residents have become captive to the freeway
network.
•  Congestion buildup required relief from early 2000’s.

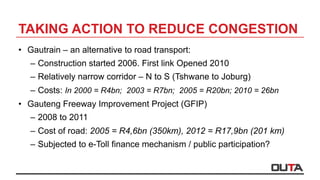

TAKING ACTION TO REDUCE CONGESTION
•  Gautrain – an alternative to road transport:
–  Construction started 2006. First link Opened 2010
–  Relatively narrow corridor – N to S (Tshwane to Joburg)
–  Costs: In 2000 = R4bn; 2003 = R7bn; 2005 = R20bn; 2010 = 26bn
•  Gauteng Freeway Improvement Project (GFIP)
–  2008 to 2011
–  Cost of road: 2005 = R4,6bn (350km), 2012 = R17,9bn (201 km)
–  Subjected to e-Toll finance mechanism / public participation?

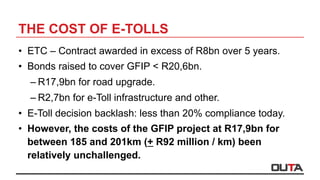

THE COST OF E-TOLLS
•  ETC – Contract awarded in excess of R8bn over 5 years.
•  Bonds raised to cover GFIP < R20,6bn.
– R17,9bn for road upgrade.
– R2,7bn for e-Toll infrastructure and other.
•  E-Toll decision backlash: less than 20% compliance today.
•  However, the costs of the GFIP project at R17,9bn for
between 185 and 201km (+ R92 million / km) been
relatively unchallenged.

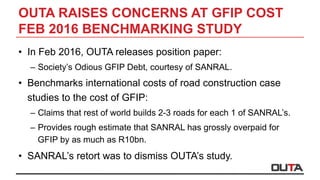

OUTA RAISES CONCERNS AT GFIP COST
FEB 2016 BENCHMARKING STUDY
•  In Feb 2016, OUTA releases position paper:
–  Society’s Odious GFIP Debt, courtesy of SANRAL.
•  Benchmarks international costs of road construction case
studies to the cost of GFIP:
–  Claims that rest of world builds 2-3 roads for each 1 of SANRAL’s.
–  Provides rough estimate that SANRAL has grossly overpaid for
GFIP by as much as R10bn.
•  SANRAL’s retort was to dismiss OUTA’s study.
SANRAL’S RETORT – APRIL 2016
•  23 March 2016: 28 Page letter from Werksmans > OUTA claims and
inferences were actionable. Demanded answers to 420 questions.
•  OUTA indicated interest in responding directly with SANRAL.
•  In April 2016, SANRAL’s press conference denounced OUTA’s
benchmarking exercise.
•  They cited an “incorrect” reference to the “Delft Impact Study” and implied
that OUTA got its “billions mixed up with millions”.
•  Their claim was wrong & OUTA’s reference was in fact correct.
•  What SANRAL did not do, was to make a strong an resounding claim that
R17,9bn was fair value for the GFIP.
•  SANRAL’s reaction set OUTA off on a project to determine the actual extent
of the excess involved in GFIP construction cost.
OUTA’S UPDATED POSITION PAPER

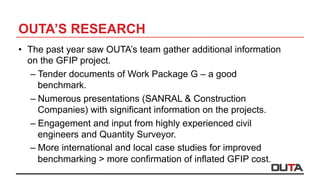

OUTA’S RESEARCH
•  The past year saw OUTA’s team gather additional information
on the GFIP project.
– Tender documents of Work Package G – a good
benchmark.
– Numerous presentations (SANRAL & Construction
Companies) with significant information on the projects.
– Engagement and input from highly experienced civil
engineers and Quantity Surveyor.
– More international and local case studies for improved
benchmarking > more confirmation of inflated GFIP cost.
OVERVIEW
•  Inconsistencies in SANRAL’s reporting on GFIP cost & Length
Distance and cost of GFIP as reported by SANRAL over time
Source Date Distance Cost
SANRAL’s Declaration of Intent (2005 – 2008) 2005 340km R4.6 billion
GFIP: Road Design Alternatives and Material
Consumption Estimates
2008 180km Unknown
Gauteng Freeway Improvement Project: Update on Phase
1 Construction
2009 185km R14,9 billion
Gauteng Freeway Improvement Project GFIP: Current and
Future Phases
2011 201km Unknown
SANRAL Construction Costs 2011 201km R17,9 billion
Nazir Alli presentation: Bidding Procedures, Monitoring
and Management of Public Works in Transportation
2012 184km R11,4 billion

...FINDINGS AND ANALYSIS
Work
Package
Project	Description
(Including	Road,	Structure	works,	Lighting	&	markings)
Distance
(km)
	Amount
(excl	vat)
	Contract	Price
Adjustment
	VAT	 	Total	Actual	Cost
A1	&	A2
N1	-	20	(From	Golden	Highway	to	14th	Ave)
N12	-	18	(From	Uncle	Charlies	-	Diepkloof)
18 						1,117,094,584	 								122,880,404	 								173,596,498	 							1,413,571,487
B N1	-	20	(From	14th	Avenue	-	Buccleuch) 21 						1,675,916,119	 								239,656,005	 								268,180,097	 							2,183,752,221
C N1	-	20&21	(From	Buccleuch	-	Brakfontein) 23 						1,492,478,366	 								213,424,406	 								238,826,388	 							1,944,729,160
D1 N1	-	21	(From	Brakfontein	-	Flying	Saucer) 10 						1,046,331,801	 								149,625,448	 								167,434,015	 							1,363,391,263
D2 N1	-	21	(Atterbury	-	Scientia) 5 										596,218,965	 										85,259,312	 										95,406,959	 											776,885,235
D3 N1	-	21	(Flying	Saucer	-	Atterbury) 6 										263,008,100	 										27,000,000	 										40,601,134	 											330,609,234
E1 N3	-	12	(Heidelberg	-	Geldenhuys) 12
E2 N12	-	18	(From	Reading	-	Elands) 4
E3 N12	-	18	(Uncle	Charlies	-	Reading) 12 										527,526,704	 										52,752,671	 										81,239,112	 											661,518,487
F N3	-	12	(Geldenhuys	-	Buccleuch) 18 						1,149,695,508	 								164,406,458	 								183,974,275	 							1,498,076,241
G R21	-	2	(Olifantsfontein	-	Hans	Strydom) 17.6 										631,000,000	 										69,410,000	 										98,057,400	 											798,467,400
H R21	-	1	(Benoni	-	Olifantsfontein) 12 										535,427,551	 										58,897,031	 										83,205,441	 											677,530,023
I N12	-	19	(Gillooly's	-	Rietfontein) 10 						1,102,283,849	 								125,000,000	 								171,819,739	 							1,399,103,587
J R21	-	1	(Rietfontein	-	Pomona) 5 										348,002,527	 										34,800,000	 										53,592,354	 											436,394,880
K N12	-	19	(Rietfontein	-	Tom	Jones) 9.5 										701,669,523	 										55,000,000	 								105,933,733	 											862,603,256
? Tom	Jones	-	Putfontein	(distance	est.) 6 										511,657,325	 										49,483,720	 										78,559,746	 											639,700,791
? Pomona	to	Benoni	(distance	est.) 4 												76,616,543	 													3,830,827	 										11,262,632	 													91,710,002
193 				13,598,643,010	 					1,752,339,346	 					2,149,137,530	 					17,500,119,886
Precast	Concrete	Barriers	(Tender	1) 										230,076,364	 										13,804,582	 										34,143,332	 											278,024,278
Precast	Concrete	Barriers	(Tender	2) 												86,165,638	 													6,592,194	 										12,986,096	 											105,743,928
193 	13,914,885,011	 		1,772,736,122	 		2,196,266,959	 			17,883,888,092
SANRAL's	COST	BREAKDOWN	PER	PROJECT
								297,448,005	 							2,422,076,616
	TOTAL	without	Barriers	(17	Projects)
	TOTAL	with	Barriers	(19	Projects)
127
						1,823,715,546	 								300,913,065
Median
Barriers
Johannesburg
Boksburg
Kempton
Park
Tembisa
Midrand
Olifantsfontein
Pretoria
Centurion
Sandton
Randburg
Roodepoort
Soweto
Alberton
Brakpan
Lanseria
M5
42
40
Watermeyer
Hans Strydom
Irene
Brakfontein
Heuweloord
Samrand
Hans Strijdom
Scientia
John Vorster
Clubview
Trichard St
Eufees rd
Rigel
Flying Saucer
Atterbury
Lynnwood
Simon Vermooten
Diepsloot
Nellmapius
Rossouw
Rooihuiskraal
Olifantsfontein
New Road
Bapsfontein
Birchleigh
Buccleuch
Allandale
Malibongwe Dr
William Nicol
Rivonia
Woodmead
Marlboro
Beyers Naude
14th Ave
Gordon Rd
Maraisburg
Marlboro
Grayston Dr
Corlett Dr
Athol Oaklands
Glenhove Rd
0
11th Ave
Houghton Dr
Oxford Rd
Empire Rd
Smit Str
Crown
Westgate
Village Rd
Rissik St
Heidelberg Rd
Heidelberg Rd
Maritzburg
Ruven Rd
Chilvers St
Cleveland Rd
Geldenhuys
Gillooly's
Van Buuren Rd
Eastgate
Linksfield Rd
Modderfontein Rd
Edenvale
London Rd
PWV3
Edenvale
Van Riebeeck Ave
Barbara Rd
Voortrekker Rd
Pomona
Atlas Rd
Kraft Rd Jet Park Rd
Rondebult Rd
Atlas Rd
R21
PWV15
Diepkloof Uncle Charlies
Columbine
Xavier St
Xavier
Booysens Rd
Vickers Rd City Deep
Rand Airport
Elands
Voortrekker Rd
Reading
Comaro Str
Klipriver
Grey Ave
Wits Rifles Rd
Osborn Rd
Mapleton R21
Golden Highway R533
Griffiths Rd
Golden Highway
Kliprivier Dr
R59
Michelle Ave
Swartkoppies Rd
Leondale
Barry Marais Rd
Grasmere
Eldorado Park
Lenasia
Dalpark
Denne Rd Ergo Rd
Tonk Meter Rd
PWV15
Tom Jones
Snake Rd
Putfontein Daveyton
Garsfontein (new)
Germiston
Olifantsfontein
Soweto
N17 / N1
N1
N17
N4
N17
N17
N4
N1
N3
R21
N1
N4
0 10 20 30 405
Kilometers I
O.R Tambo
International
Airport
W
orkPacka
ge B
WorkPackageC
WorkPackageG
WorkPackageH
Work Package
D1
Work
Package
D3
Work
Package
D2
Work
PackageJ
Work Package I
Work Pakage K
Work
PackageF
Work
Package E2
Work
Pack
ageE1
Work Pakage E3
W
orkPackageA1
GFIP	OVERVIEW
•  The	GFIP	–	A	mul.	package	project.
•  2008	to	2011/12.
•  Major	construc.on	companies	&
some	smaller	en..es	plus	JVs.
•  Roughly	27%	increase	in	surface	area.
•  Thus	73%	rehabilita.on	of	exis.ng
road	surface	area.
•  Some	packages	had	more	structural
(bridge)	work	than	others.
•  Some	packages	had	more	interchange
work	than	others.

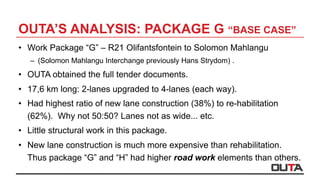

OUTA’S ANALYSIS: PACKAGE G “BASE CASE”
•  Work Package “G” – R21 Olifantsfontein to Solomon Mahlangu
–  (Solomon Mahlangu Interchange previously Hans Strydom) .
•  OUTA obtained the full tender documents.
•  17,6 km long: 2-lanes upgraded to 4-lanes (each way).
•  Had highest ratio of new lane construction (38%) to re-habilitation
(62%). Why not 50:50? Lanes not as wide... etc.
•  Little structural work in this package.
•  New lane construction is much more expensive than rehabilitation.
Thus package “G” and “H” had higher road work elements than others.

OUTA's	WORK	PACKAGE	"G"	COST	CALCULATION	(ZAR)
SCHEDULE Package	G
TOTAL	SCHEDULE	B:	Structures 16,508,420
TOTAL	SCHEDULE	D:	Govt	requirements	for	BBBEE 1,040,000
TOTAL	SCHEDULE	E:	Electrical 37,520,883
TOTAL	SCHEDULE	F:	Ultra	thin	friction	course 45,260,000
TOTAL	SCHEDULE	H:	Alternative	Road	works 486,354,997
TOTAL	SCHEDULES	 586,684,300
Contract	Price	Adjustment 29,598,222
TOTAL	(Excluding	VAT) 616,282,522
ADD	14%	VAT 86,279,553
TOTAL	WORKPACKAGE	COST	 702,562,075
Length	of	the	Work	Package	(km) 17.6
Ave.	Cost	/	km	(Including	Lighting) 39,918,300
SANRAL's	PAID	TENDER 798,467,400
SANRAL's	Cost	per	KM	for	Work	Package 45,367,466
COST	VARIANCE:	Overpriced	/	(Underpriced) 95,905,325
PERCENTAGE	VARIANCE 13.7%
Package	“G”	Overview
•  Applying	Quan..es	and	indices	as
per	tender	docs	&	material	/	input
costs.
•  Tenders	asked	for	cos.ng	within	&
without	more	expensive	UTCRCP
(Ultra	Thin	Con.nuously	Reinforced	Concrete	Paving	).
•  The	opinion	without	was	used.
•  Cost	of	Package	G:	R703	million
•  Ave	R40	mil	/	kilometer.
•  A	good	base	for	other	packages,
excluding	structural	work.
•  Lowest	variance.

OUTA’S ANALYSIS – METHODOLOGY 1
														39,918,300
Work
Package
Project	Description
Distance
(km)
	OUTA	Indicative
Amount	(Incl	VAT)
	SANRAL's	Price
Paid	(Incl	VAT)
	Value	Variance
	%
Variance
A
N1	-	20	(From	Golden	Highway	to	14th	Ave)
N12	-	18	(From	Uncle	Charlies	-	Diepkloof)
18 										718,529,400	 								1,413,571,487	 												695,042,087	 97%
B N1	-	20	(From	14th	Avenue	-	Buccleuch) 21 										838,284,300	 								2,183,752,221	 									1,345,467,921	 161%
C N1	-	20&21	(From	Buccleuch	-	Brakfontein) 23 										918,120,900	 								1,944,729,160	 									1,026,608,260	 112%
D1 N1	-	21	(From	Brakfontein	-	Flying	Saucer) 10 										399,183,000	 								1,363,391,263	 												964,208,263	 242%
D2 N1	-	21	(Atterbury	-	Scientia) 5 										199,591,500	 												776,885,235	 												577,293,735	 289%
D3 N1	-	21	(Flying	Saucer	-	Atterbury) 6 										239,509,800	 												330,609,234	 														91,099,434	 38%
E1 N3	-	12	(Heidelberg	-	Geldenhuys) 12 										479,019,600
E2 N12	-	18	(From	Reading	-	Elands) 4 										159,673,200
E3 N12	-	18	(Uncle	Charlies	-	Reading) 12 										479,019,600	 												661,518,487	 												182,498,887	 38%
F N3	-	12	(Geldenhuys	-	Buccleuch) 18 										718,529,400	 								1,498,076,241	 												779,546,841	 108%
G R21	-	2	(Olifantsfontein	-	Hans	Strydom) 17.6 										702,562,080	 												798,467,400	 														95,905,320	 14%
H R21	-	1	(Benoni	-	Olifantsfontein) 12 										479,019,600	 												677,530,023	 												198,510,423	 41%

I N12	-	19	(Gillooly's	-	Rietfontein) 10 										399,183,000	 								1,399,103,587	 												999,920,587	 250%
J R21	-	1	(Rietfontein	-	Pomona) 5 										199,591,500	 												436,394,880	 												236,803,380	 119%
K N12	-	19	(Rietfontein	-	Tom	Jones) 9.5 										379,223,850	 												862,603,256	 												483,379,406	 127%
? Tom	Jones	-	Putfontein	 6 										239,509,800	 												639,700,791	 												400,190,991	 167%
? Pomona	to	Benoni 4 										159,673,200	 														91,710,002	 -													67,963,198	 -43%
193 		7,708,223,730	 	17,500,119,886	 				9,791,896,156	 127%
Precast	Concrete	Barriers	(Tender	1) 										278,024,278	 												278,024,278	 																													-
Precast	Concrete	Barriers	(Tender	2) 										105,743,928	 												105,743,928	 																													-
				8,091,991,936	 			17,883,888,092	 						9,791,896,156	 121%
127
	TOTAL	with	Barriers	(19	Projects)
Median
Barriers
Using	Work	Package	G	as	a	"Base	Case"	/	km	cost	for	G:
METHODOLOGY	1
								2,422,076,616	 									1,783,383,816	 279%
	TOTAL	without	median	barriers	(17	Projects)
OUTA	Obtained	a	copy	of
this	presenta.on:

Louw	Kannemeyer	is	a
Network	Manager	at
SANRAL

Presented	around	the	.me
the	GFIP	tenders	were
being	finalised

Contained	key	quan..es
for	some	work	packages
SLIDE 13: SANRAL’S KEY QUANTITIES
PACKAGES: A (1&2), B, C, D(1&2) E(1&2) F
D1 D2 C F A1-A2 B E1 E2
Brakfontein to
N1/R21 I/C
Atterbury to
Proefplaas
Buccleuch to
Brakfontein
Geldenhuis to
Buccleuch
14th Avenue
to Uncle
Charlies
14th Avenue
to Buccleuch
Old Barn to
Geldenhuis
Reading to
Elands I/C
Section 2200 Concrete 670.00 m3 195.00 m3 1930.00 m3 180.00 m3 312.00 m3 750.00 m3 336.00 m3 825.00 m3 5198.00 m3
Prefabricated Culverts Reinforcing 15.50 t 13.00 t 35.00 t 25.00 t 8.90 t 10.00 t 22.40 t 9.20 t 139.00 t
Section 2300 Concrete 2620.00 m3 2510.00 m3 280.00 m3 4495.00 m3 5785.00 m3 11740.00 m3 1540.00 m3 2125.00 m3 31095.00 m3
Open Drains Reinforcing 48.40 t 37.00 t 2.50 t 61.60 t 13.50 t 134.00 t 53.00 t 41.50 t 391.50 t
Section 4100 Prime Prime 160000.00 l 180000.00 l 424400.00 l 24360.00 l 241840.00 l 147000.00 l 77000.00 l 60000.00 l 1314600.00 l
Tack Coat 30%
Stable Grade
Emulsion
310000.00 l 93600.00 l 1150000.00 l 562342.00 l 424225.00 l 156000.00 l 840000.00 l 140000.00 l 3676167.00 l
Semi Gap 19mm
max AR1
6640.00 t 6640.00 t
Base 40/50 pen bit.
With 26.5mm
159450.00 t 11986.00 t 17320.50 t 64045.00 t 35200.00 t 4221.67 t 292223.17 t
Continuously
Graded
30950.00 t 12130.00 t 26488.00 t 9239.00 t 1180.00 t 44000.00 t 89000.00 t 2875.00 t 215862.00 t
Semi open grade
bitumen rubber
12510.00 t 79000.00 t 16700.00 t 108210.00 t
Concrete 20391.00 m3 9724.00 m3 32212.00 m3 12672.00 m3 5856.00 m3 26508.50 m3 15962.30 m3 16329.00 m3 139654.80 m3
Reinforcing 2876.50 t 1359.00 t 3874.00 t 1579.10 t 1568.10 t 4514.20 t 1792.35 t 2814.60 t 20377.85 t
Section 7100 Concrete 5750.00 m3 3075.00 m3 29036.00 m3 16978.00 m3 7623.00 m3 30362.00 m3 1138.00 m3 93962.00 m3
Concrete Pavement Reinforcing 400.00 t 270.00 t 1504.00 t 50055.00 t 22.10 t 550.00 t 254.00 t 53055.10 t
BRASO 20831.00 t 116920.00 t 36020.00 t 173771.00 t
UTFC 50000.00 m2 50000.00 m2
Structures
Section 4200
Asphalt
GAUTENG TOLL HIGHWAY PROJECTS Total
Total Concrete 269909.80 m3
Total Reinforcing 73963.45 t
Total Prime 1314600.00 l
Total Tack Coat 3676167.00 l
Total Asphalt 796706.17 t
Total UTFC 50000.00 m2
OUTA’S ANALYSIS – METHODOLOGY 2A
•  OUTA’s road construction engineers and QS applied their analysis of this
information to:-
–  these key quantities,
–  length and width of road surface areas
–  Understanding of higher extent of structural & bridgework on these
packages.
–  Applied known costs of material applicable at the time.
–  Adjusted for COLTO standards, P&Gs, Series 3000 (Earthworks) etc.
–  Applied their extensive construction experience.
•  Added insights of another presentation by KAS JV on Work Package E1.
•  Excluded Work Package F – Steel to Concrete ratio questionable.
OUTA’S ANALYSIS – METHODOLOGY 2A
OUTA's	Calculation	of	Methodolgy	2(a)	for	Cost	of	GFIP:		Work	Packages	A,	B,	B,	D(1&2),	E(1&2)	and	G
SCHEDULE Package	G Package	A Package	B Package	C Package	D1&2
Structures 16,508,420									 49,428,973									 189,003,552						 202,648,672									 146,498,436
Govt	requirements	for	BBBEE 1,040,000											 1,216,108											 1,387,070											 1,817,169													 1,817,169
Electrical	and	lighting 37,520,883									 23,356,721									 27,249,508									 29,844,699											 19,463,934
BRASO/	UTFC/	Other	layers 									45,260,000	 184,161,777						 88,446,763									 51,150,320											 75,248,898
Road	works 							486,354,997	 338,597,160							 395,030,020							 558,340,722									 391,130,053
TOTAL	SCHEDULES	 586,684,300						 596,760,739						 701,116,912						 843,801,582									 634,158,490
Contract	Price	Adjustment 29,598,222.93 25,951,632.63 51,220,972.44 39,458,974.62 29,464,315.48
TOTAL	with	CPA 616,282,522.49 622,712,371.47 752,337,884.78 883,260,556.16 663,622,805.03
ADD	14%	VAT 86,279,553									 87,179,732									 105,327,304						 123,656,478									 92,907,193
TOTAL	WORKPACKAGE	COST	 702,562,076		 709,892,103		 857,665,189		 1,006,917,034	 756,529,998
Length	of	the	Work	Package	(km) 18																							 18																							 21 23																									 15
Ave.	Cost	/	km	(Including	Structures	&	Lighting) 39,918,300									 39,438,450									 40,841,199									 43,779,001											 50,435,333
SANRAL's	PAID	TENDER 798,467,400						 1,413,571,487			 				2,183,752,221	 1,944,729,160					 2,140,276,499
SANRAL's	Cost	per	KM	for	Work	Package 45,367,466									 78,531,749									 103,988,201						 84,553,442											 142,685,100
COST	VARIANCE:	Overpriced	/	(Underpriced) 95,905,324									 703,679,384						 1,326,087,033			 937,812,126									 1,383,746,501
PERCENTAGE	VARIANCE 14% 99% 155% 93% 183%
	Package	E1	+	E2	 Total
133,485,246								 737,573,300
1,511,532												 8,789,047
26,281,529										 163,717,273
187,955,400								 632,223,157
468,435,544								 2,637,888,496
817,669,251							 4,180,191,273
39,229,953.62 214,924,072
856,899,204.96 4,395,115,345
119,965,889								 615,316,148
976,865,094			 5,010,431,493
16																								 111
61,054,068										 45,302,274												 -
2,422,076,616				 10,902,873,384
151,379,788								 98,579,325												 -
1,445,211,522				 5,892,441,890
148% 118%
OVER	PRICED
OUTA’S ANALYSIS – ROAD WORKS EST. ONLY•  Road Works
estimate only
for Packages
A-E & G
•  Cost / KM basis
	-
	20,000,000
	40,000,000
	60,000,000
	80,000,000
	100,000,000
	120,000,000
	140,000,000
1	 2	 3	 4	 5	 6	 7
Work	Package	Cost	per	KM	for	Road	works	*
RANDS
		OUTA’s	Es<mate	Cost	/	KM
		SANRAL	Cost	/	KM	**
*	ROAD	WORKS	Costs	are	those	a3ributed	to	all	work,	less	structures,	CPA	and	VAT
**	Note:	Sanral’s	figures	are	their	own,	pre	CPA	and	less	OUTA’s	esGmate	of	Structure	costs.	All	excl.	VAT
Work	Packages	>	 A	 B	 C	 D	1&2	 AVE	(A,B,C,D,E,G)	G	 E	1&2
OUTA:	R31,1	m
SANRAL:	R86,6	m
OUTA’S ANALYSIS – METHODOLOGY 2B
More Accurate Approach
•  Using 2(a) methodology for
111 km of packages with good
costing information.
•  Combined with Package “G”
base case for remainder 82
km packages, and inflating
Structures costs.
OUTA's	Calculation	of	Methodolgy	2(b):	TOTAL	Cost	of	GFIPOUTA's	Calculation	of	Methodolgy	2(b):	TOTAL	Cost	of	GFIP
SCHEDULE
Structures
Govt	requirements	for	BBBEE
Electrical	and	lighting
BRASO/	UTFC/	Other	layers
Road	works
TOTAL	SCHEDULES
Contract	Price	Adjustment
TOTAL	with	CPA
ADD	14%	VAT
WORKPACKAGE	COST	(Excl	Barriers)
Median	Barriers	(as	per	Sanral	Tender)
TOTAL	COSTS	(Inclu	Median	Barriers)
Length	of	the	Work	Package	(km)
Ave.	Cost	/	km	(Including	Structures	&	Lighting)
SANRAL's	PAID	TENDER	(Excl	Barriers)
Median	Barriers	(as	per	Sanral	Tender)
SANRALS	TOTAL	GFIP	COSTS	(Incl	Barriers)
SANRAL's	Cost	per	KM	for	Work	Package
COST	VARIANCE:	Overpriced	/	(Underpriced)
PERCENTAGE	VARIANCE
*	Package	G	costs	adjusted	to	increase	allowance	for	Structures	and	Road	Works
OUTA's	ESTIMATES
SANRAL's
COSTS
VARIANCE
Using	Calculations	for
Methodology	2(a)
Using	Methodology	1
Work	Packages	A,	B,	C,
D(1&2),	E(1&2),	G
Ave	G	Costs*	Applied	to
Remainder	Packages
GFIP	TOTAL
737,573,300																					 277,289,421																							 1,014,862,721
8,789,047																									 4,869,091																											 13,658,138
163,717,273																					 175,665,950																							 339,383,223
632,223,157																					 211,899,091																							 844,122,248
2,637,888,496																		 2,077,025,668																			 4,714,914,164
4,180,191,273																		 2,746,749,221																			 6,926,940,494
214,924,072																					 138,573,498																							 353,497,570
4,395,115,345																		 2,885,322,719																			 7,280,438,064
615,316,148																					 403,945,181																							 1,019,261,329
5,010,431,493											 3,289,267,900												 8,299,699,393
383,768,206
8,683,467,599
111																																			 82																																							 193
45,302,274																							 39,918,300																									 44,992,060													-
10,902,873,384																 6,597,246,503																			 17,500,119,886
383,768,206
17,883,888,092
98,579,325																							 80,063,671																									 92,662,633													-
5,892,441,890																		 3,307,978,603																			 9,200,420,494
118% 101% 106%
*	Package	G	costs	adjusted	to	increase	allowance	for	Structures	and	Road	Works
SANRAL	PAID
OVER	PRICED	BY
OUTA’S ANALYSIS – METHODOLOGY 3
Square Meter Surface Calculations:
Rehab & New
•  Using combination of satellite imagery,
tenders, & known information of road
widths, OUTA estimated surface area
of New and Existing Road Works.
•  OUTA placed new road construction at
R1666 / m2
•  Rehabilitation / resurfacing at average
of R325 / m2
•  Then added earlier costing pertaining
to Lighting, Structures, CPA etc.
Methodology	3:		Applying	Cost	/	Sq	M	for	Roadworks
AREA	(Sq	M) COST	(ZAR) AREA	(Sq	M) COST	(ZAR) AREA	(Sq	M) COST	(ZAR)
New	Road	Surface	Area 1,666R			 1,182,720					 1,970,411,520						 761,223.84					 1,268,198,919												 1,943,944							 3,238,610,439
Existing	Road	Surface	Area 325R						 3,193,440					 1,037,868,000						 2,055,366.16	 667,994,002															 5,248,806							 1,705,862,002
TOTAL 4,376,160	 3,008,279,520	 2,816,590			 1,936,192,921						 7,192,750			 4,944,472,441
Total	per	Sq	M 687R
Lighting 163,717,273									 175,665,950.24										 339383223
Structures 737,573,300									 277,289,421															 1,014,862,721
TOTAL 3,909,570,093	 2,389,148,292						 6,298,718,385
Remaining	82	km	of	GFIP
AREA	of	A,	B,	C,	D(1&2),
E(1&2),	&	GCost	/	Sq
M	Applied
TOTAL	GFIP
ITEMS	COSTED
CSI	&	BBBEE	 8,789,047														 4,869,090.91														 13,658,138.11
Contract	Price	Adj 214,924,072									 138,573,498.26										 353,497,569.98
Median	Barriers 383,768,205.78
TOTAL		 4,133,283,212	 2,532,590,881						 7,049,642,299
VAT	(@	14%) 578,659,650									 354,562,723															 986,949,922
TOTAL	Including	VAT 1,117R			 4,711,942,862	 -													 2,887,153,605						 8,036,592,221
SANRAL	PAID	> 17,880,000,000
SANRAL's	COST	/	Sq	M: 2,486R			 2,485.84
SUMMARY OF OUTA’S ANALYSIS
3 METHODOLOGIES
VARIOUS ASSESSMENTS ALIGN
•  Whichever way we look at it, we
come in at around R8,3bn.
•  OUTA realises that SANRAL will
seek more flaws and errors to
denounce our findings, analysis
and claims.
•  Which is why we now seek the
actual and full information – in
electronic format .
•  Without excuses of secrecy due
to privileged information etc.
SUMMARY	AND	COMPARISONS	OF	OUTA's	THREE	CALCULATION	METHODOLOGIES
METHOD COST	OF	GFIP	 METHOD	DESCRIPTION
Method	1 8,091,991,936
Using	Engineers	calculation	Package	G	tender	documents	as	(base
case)	per	KM	for	all	packages
Method	2(b) 8,683,467,599
Using	Engineers	calculation	of	Key	Quantities	obtained	for	Several
Work	Packages	(A,	B,	C,	D,	E,	G)	and	applying	Package	G	(base	case
cost	/	KM)	to	remainder	of	packages	(82km)
Method	3 8,036,592,221
Applying	the	figure	of	R325/m²	for	rehabilitation	work(5,248,806
m2)	and	R1666/m²	for	added	surface	area	(1,943,944	m2)	and
adding	costs	pertaining	to	structures,	lighting	and	median	barriers.
AVERAGE 8,270,683,918							 Taking	an	average	of	the	above	three	methodologies
SANRAL 17,883,888,092				 The	actual	figure	paid	by	SANRAL	for	the	GFIP
DIFFERENCE 9,613,204,174
%	Variance 116%
The	amount	OUTA	believe	that	SANRAL	overpaid	for	the	GFIP
OUTA's	ASSESSMENT	OF	WORK	PACKAGE	"I"
SCHEDULE		(Gillooly's	to	Rietfontein	IC) Package	I
SANRAL's	Cost	of	Work	Package	I	(before	CPA	&	VAT) 1,102,283,849
Estimate	Structure	Costs	by	OUTA	(Maximum) 150,000,000
OUTA's	Est	of	SANRAL's	Cost	of	Road	works:																						(excluding
Structures,	CPA,	VAT)
952,283,849
Length	of	Package: 10
Roadwork	cost	per	KM	(Excluding	VAT	&	CPA): 95,228,385
OUTA's	Estimate	of	Road	Work	per	KM:
(Adjusted	for	higher	cost	of	Ultra	Thin	Continuously	Concrete	Technology	applied)
32,500,000
Overpricing	of	Work	Package	I	per	KM: 62,728,385
%	Variance: 193%
MORE ANOMOLIES: WORK PACKAGE “I”
WORK PACKAGE I
•  A simple route: Gillooly’s to Rietfontein.
•  10 KM long with limited interchange work.
•  Infrastructure work (Flyover and minimal
bridge work) estimated at R150m.
•  SANRAL paid R1,4 bn for this package.
•  Excluding CPA and VAT, and less Structures
estimate: SANRAL paid R952m.
•  That is R95m / km for Road Work !!!!
•  OUTA estimates 193% overpaid for road
works
CONTRACT PRICE ADJUSTMENT (CPA)
Contract Price Adjustments (CPA) on GFIP
•  CPA a standard adjustment, based on escalation
indices provided by StatsSA monthly.
•  Accounts for uncontrollable fluctuations (Fuel,
Steel, Bitumen etc) are credited (or debited)
•  Naturally, the higher the price of project, the
higher the value of CPA.
•  OUTA’s GFIP costs, applied to the actual CPA
indicies = R215 m due to CPA (limited packages)
•  SANRAL’s high costs of GFIP and apparent
inflated CPA = 450% higher.
•  OUTA estimates on total Package, SANRAL may
have overcompensated contractors by over R1bn.
Work	Package 	SANRAL	Paid	 	OUTA	Calculations	 %	Variance
A 										122,880,404	 25,951,632														 373%
B 										239,656,005	 51,220,972														 368%
C 										213,424,406	 39,458,975														 441%
D1
D2
E1
E2
G 											69,410,000	 29,598,222														 135%
TOTAL 1,181,168,640			 214,924,071										 450%
Contract	Price	Adjustment	on	GFIP	(limited	packages)
										300,913,065
29,464,316
39,229,954
697%
667%
										234,884,760
BENCHMARKING IN AFRICA
ETHIOPIA: ADDIS ABABA to ADAMA Expressway
•  Completed 2014.
•  Greenfields project – 6 new lanes (3 each way).
•  84 KM plus 18km link roads, 7,2 km front roads.
•  Area: 2,625,700 m2
•  Rand Value: R4,1 billion (2008).
•  Cost / km: R47,4 m
•  Cost / m2: R1,541
•  COMPARED TO GFIP: R2,486 / m2
BENCHMARKING IN USA
KATY Freeway – Houston Texas
•  Completed 2006, Widening - 22 lanes
•  Bridge structures upgraded, rail line relocated
•  Cost / m2: R1,359. GFIP: R2,486
OTHER BENCHMARK PROJECTS
BENCHMARK EXERCISE TO COMPARE GFIP ON COST / KM or m2 BASIS
Benchmark Ref # 7: Project Name: Addis Ababa–Adama Expressway
Year KM m² Value ($) (2014) Value ($) (2008) Value (ZAR)** Cost ZAR/km
Cost
ZAR/m²
2014 84.7 2,625,700 700,000,000 493,472,378 4,046,473,500 47,774,185 1,541
Benchmark Ref #8: Project Name: Nairobi-Thika Superhighway Upgrade
Year KM m² Value ($) (2012) Value ($) (2008) Value (ZAR)** Cost ZAR/km
Cost
ZAR/m²
2012 50 1,700,000 360,000,000 285,153,719 2,338,260,496 46,765,210 1,375
Benchmark Ref # 9: Project Name: Tonota to Francistown
Year KM m² Value ($) (2014) Value ($) (2008) Value (ZAR)** Cost ZAR/km
Cost
ZAR/m²
2015 30 744,000 113,000,000 89,506,584 733,953,989 24,465,133 986
Benchmark Ref # 11: Project: The Katy Freeway (IH-10)
Year KM m² Value ($) (2006) Value ($) (2008) Value (ZAR)** Cost ZAR/km
Cost
ZAR/m²
2006 11.1 1,409,700 208,000,000 233,708,800 1,916,412,160 172,649,744 1,359
Benchmark Ref #12: Western Europe - Western China International Transit Corridor (CAREC - 1b)
Year KM m² Value ($) (2006) Value ($) (2008) Value (ZAR)** Cost ZAR/km
Cost
ZAR/m²
2012 305 8,387,500 1,256,000,000 994,869,641 8,157,931,056 26,747,315 973
Benchmark Ref #13: PATHE - Section Maliakos - Kleidi Motorway PPP, Greece
Year KM m² Value (€) (2012) Value (€) (2008) Value (ZAR)** Cost ZAR/km
2012 230 8,387,500 1,256,000,000 994,869,641 11,938,435,692 51,906,242
SANRAL's PRICE PAID FOR GFIP
Year KM m² Value (ZAR)** Cost ZAR/km
Cost
ZAR/m²
2008 193 7,192,750 17,880,000,000 92,642,487 2,486
** Deflated to 2008 Prices and R : $ Exchange rate at the time
BENCHMARKING
•  Always best to compare by M2 – if
one can get the figure.
•  Fine to do by KM if similar in width
•  Try to compare similar type projects,
eg. upgrade, widening etc.
•  Convert to KM, Rands and Inflation.
•  OUTA Research: Generally, other
projects were more complex, had
more new road works.
•  We maintain that benchmarking with
International projects (built to
COLTO, FIDIC and World Bank
standards) is an acceptable method
of comparison.
•  How else does one tell if local
markets are being manipulated?
TOO MANY QUESTIONS
•  SANRAL are the experts in this game – how did they allow
such high pricing to prevail?
•  Why did SANRAL not act faster to claw back the overcharges?
•  Why is construction industry being “protected”?
•  Why did CIDB halt its in-depth investigations into the matter?
•  Why have SAFCEC and SAICE not taken SANRAL and the
industry to task?
CONCLUSIONS
•  The GFIP Price-tag of R17,9 bn is excessively overpriced.
•  OUTA estimates value of between R8bn and R9bn (Less than ½ ).
•  SANRAL has not been transparent and forthcoming with details
and full explanations of how it arrived at R17,9bn.
•  Information is missing on internet, when compared to other info.
•  Even if OUTA has missed the mark by as much as 20%, the
price-tag remains excessive.
•  This issue will not abate until transparency and a full
independent enquiry is commissioned.
RECOMMENDATIONS
•  OUTA will send letters to relevant Ministers for request to intervene.
•  OUTA will request that if SANRAL management is implicated or did
not act in the best interests of the public:
–  E-Tolls is scrapped forthwith.
–  Corrective action is taken against ALL transgressors.
•  The recent agreement between Government and Construction
Industry players be revisited - as “punishment” imposed is hardly
punitive.
•  Civil claims are re-opened against construction industry for
collusion and adequate penalties are applied.
...RECOMMENDATIONS
•  That oversight & industry bodies explain why they have been silent
on this issue.
•  That the N3 Cedara – Durban project (and others) tenders are fully
investigated: R15bn for a 78km upgrade project.
•  That a Transport Regulator is introduced to monitor industry
matters (An agreement was reached with The Road Freight
Association that this would happen in 2012).
•  That in conjunction with the introduction of a Transport Regulator,
Government appoints an oversight body (that includes input from
Civil Society) to monitor road construction pricing and tenders with
the state.
THANK YOU
•  Questions ?

Gauteng Freeway Improvement Plan (GFIP) Costs

  • 1.
    “THE ROAD TOEXCESS” SANRAL’S HIGH COST OF ROAD CONSTRUCTION IN SOUTH AFRICA & THE OVERPAYMENT OF ALMOST R10BN ON GAUTENG’S FREEWAY UPGRADE
  • 2.
    WHO IS OUTA? OUTAis a proudly South African non-profit Civil Action Organisation, comprising of and supported by people who are passionate about improving the prosperity of our nation. The conduct of excessive costs related to state controlled capital expenditure projects is a grave problem in South Africa. Our nation has become poorer as a result of this growing problem. OUTA’s mandate is to expose and challenge the abuse of authority, be it through maladministration and / or corruption.
  • 3.
    GAUTENG’S GROWING CONGESTION • Gauteng commuting has been problematic. •  Apartheid developmental policies of segregation pushed the poor far from places of work. •  Public transport infrastructure insufficient to cope. •  Roads Transport (Mini-Bus Taxi’s and Cars) have become the main method of commuting. •  Gauteng residents have become captive to the freeway network. •  Congestion buildup required relief from early 2000’s.
  • 4.
    TAKING ACTION TOREDUCE CONGESTION •  Gautrain – an alternative to road transport: –  Construction started 2006. First link Opened 2010 –  Relatively narrow corridor – N to S (Tshwane to Joburg) –  Costs: In 2000 = R4bn; 2003 = R7bn; 2005 = R20bn; 2010 = 26bn •  Gauteng Freeway Improvement Project (GFIP) –  2008 to 2011 –  Cost of road: 2005 = R4,6bn (350km), 2012 = R17,9bn (201 km) –  Subjected to e-Toll finance mechanism / public participation?
  • 5.
    THE COST OFE-TOLLS •  ETC – Contract awarded in excess of R8bn over 5 years. •  Bonds raised to cover GFIP < R20,6bn. – R17,9bn for road upgrade. – R2,7bn for e-Toll infrastructure and other. •  E-Toll decision backlash: less than 20% compliance today. •  However, the costs of the GFIP project at R17,9bn for between 185 and 201km (+ R92 million / km) been relatively unchallenged.
  • 6.
    OUTA RAISES CONCERNSAT GFIP COST FEB 2016 BENCHMARKING STUDY •  In Feb 2016, OUTA releases position paper: –  Society’s Odious GFIP Debt, courtesy of SANRAL. •  Benchmarks international costs of road construction case studies to the cost of GFIP: –  Claims that rest of world builds 2-3 roads for each 1 of SANRAL’s. –  Provides rough estimate that SANRAL has grossly overpaid for GFIP by as much as R10bn. •  SANRAL’s retort was to dismiss OUTA’s study.
  • 7.
    SANRAL’S RETORT –APRIL 2016 •  23 March 2016: 28 Page letter from Werksmans > OUTA claims and inferences were actionable. Demanded answers to 420 questions. •  OUTA indicated interest in responding directly with SANRAL. •  In April 2016, SANRAL’s press conference denounced OUTA’s benchmarking exercise. •  They cited an “incorrect” reference to the “Delft Impact Study” and implied that OUTA got its “billions mixed up with millions”. •  Their claim was wrong & OUTA’s reference was in fact correct. •  What SANRAL did not do, was to make a strong an resounding claim that R17,9bn was fair value for the GFIP. •  SANRAL’s reaction set OUTA off on a project to determine the actual extent of the excess involved in GFIP construction cost.
  • 8.
  • 9.
    OUTA’S RESEARCH •  Thepast year saw OUTA’s team gather additional information on the GFIP project. – Tender documents of Work Package G – a good benchmark. – Numerous presentations (SANRAL & Construction Companies) with significant information on the projects. – Engagement and input from highly experienced civil engineers and Quantity Surveyor. – More international and local case studies for improved benchmarking > more confirmation of inflated GFIP cost.
  • 10.
    OVERVIEW •  Inconsistencies inSANRAL’s reporting on GFIP cost & Length Distance and cost of GFIP as reported by SANRAL over time Source Date Distance Cost SANRAL’s Declaration of Intent (2005 – 2008) 2005 340km R4.6 billion GFIP: Road Design Alternatives and Material Consumption Estimates 2008 180km Unknown Gauteng Freeway Improvement Project: Update on Phase 1 Construction 2009 185km R14,9 billion Gauteng Freeway Improvement Project GFIP: Current and Future Phases 2011 201km Unknown SANRAL Construction Costs 2011 201km R17,9 billion Nazir Alli presentation: Bidding Procedures, Monitoring and Management of Public Works in Transportation 2012 184km R11,4 billion
  • 11.
    ...FINDINGS AND ANALYSIS Work Package Project Description (Including Road, Structure works, Lighting & markings) Distance (km) Amount (excl vat) Contract Price Adjustment VAT Total Actual Cost A1 & A2 N1 - 20 (From Golden Highway to 14th Ave) N12 - 18 (From Uncle Charlies - Diepkloof) 18 1,117,094,584 122,880,404 173,596,498 1,413,571,487 B N1 - 20 (From 14th Avenue - Buccleuch) 21 1,675,916,119 239,656,005 268,180,097 2,183,752,221 C N1 - 20&21 (From Buccleuch - Brakfontein) 23 1,492,478,366 213,424,406 238,826,388 1,944,729,160 D1 N1 - 21 (From Brakfontein - Flying Saucer) 10 1,046,331,801 149,625,448 167,434,015 1,363,391,263 D2 N1 - 21 (Atterbury - Scientia) 5 596,218,965 85,259,312 95,406,959 776,885,235 D3 N1 - 21 (Flying Saucer - Atterbury) 6 263,008,100 27,000,000 40,601,134 330,609,234 E1 N3 - 12 (Heidelberg - Geldenhuys) 12 E2 N12 - 18 (From Reading - Elands) 4 E3 N12 - 18 (Uncle Charlies - Reading) 12 527,526,704 52,752,671 81,239,112 661,518,487 F N3 - 12 (Geldenhuys - Buccleuch) 18 1,149,695,508 164,406,458 183,974,275 1,498,076,241 G R21 - 2 (Olifantsfontein - Hans Strydom) 17.6 631,000,000 69,410,000 98,057,400 798,467,400 H R21 - 1 (Benoni - Olifantsfontein) 12 535,427,551 58,897,031 83,205,441 677,530,023 I N12 - 19 (Gillooly's - Rietfontein) 10 1,102,283,849 125,000,000 171,819,739 1,399,103,587 J R21 - 1 (Rietfontein - Pomona) 5 348,002,527 34,800,000 53,592,354 436,394,880 K N12 - 19 (Rietfontein - Tom Jones) 9.5 701,669,523 55,000,000 105,933,733 862,603,256 ? Tom Jones - Putfontein (distance est.) 6 511,657,325 49,483,720 78,559,746 639,700,791 ? Pomona to Benoni (distance est.) 4 76,616,543 3,830,827 11,262,632 91,710,002 193 13,598,643,010 1,752,339,346 2,149,137,530 17,500,119,886 Precast Concrete Barriers (Tender 1) 230,076,364 13,804,582 34,143,332 278,024,278 Precast Concrete Barriers (Tender 2) 86,165,638 6,592,194 12,986,096 105,743,928 193 13,914,885,011 1,772,736,122 2,196,266,959 17,883,888,092 SANRAL's COST BREAKDOWN PER PROJECT 297,448,005 2,422,076,616 TOTAL without Barriers (17 Projects) TOTAL with Barriers (19 Projects) 127 1,823,715,546 300,913,065 Median Barriers
  • 12.
    Johannesburg Boksburg Kempton Park Tembisa Midrand Olifantsfontein Pretoria Centurion Sandton Randburg Roodepoort Soweto Alberton Brakpan Lanseria M5 42 40 Watermeyer Hans Strydom Irene Brakfontein Heuweloord Samrand Hans Strijdom Scientia JohnVorster Clubview Trichard St Eufees rd Rigel Flying Saucer Atterbury Lynnwood Simon Vermooten Diepsloot Nellmapius Rossouw Rooihuiskraal Olifantsfontein New Road Bapsfontein Birchleigh Buccleuch Allandale Malibongwe Dr William Nicol Rivonia Woodmead Marlboro Beyers Naude 14th Ave Gordon Rd Maraisburg Marlboro Grayston Dr Corlett Dr Athol Oaklands Glenhove Rd 0 11th Ave Houghton Dr Oxford Rd Empire Rd Smit Str Crown Westgate Village Rd Rissik St Heidelberg Rd Heidelberg Rd Maritzburg Ruven Rd Chilvers St Cleveland Rd Geldenhuys Gillooly's Van Buuren Rd Eastgate Linksfield Rd Modderfontein Rd Edenvale London Rd PWV3 Edenvale Van Riebeeck Ave Barbara Rd Voortrekker Rd Pomona Atlas Rd Kraft Rd Jet Park Rd Rondebult Rd Atlas Rd R21 PWV15 Diepkloof Uncle Charlies Columbine Xavier St Xavier Booysens Rd Vickers Rd City Deep Rand Airport Elands Voortrekker Rd Reading Comaro Str Klipriver Grey Ave Wits Rifles Rd Osborn Rd Mapleton R21 Golden Highway R533 Griffiths Rd Golden Highway Kliprivier Dr R59 Michelle Ave Swartkoppies Rd Leondale Barry Marais Rd Grasmere Eldorado Park Lenasia Dalpark Denne Rd Ergo Rd Tonk Meter Rd PWV15 Tom Jones Snake Rd Putfontein Daveyton Garsfontein (new) Germiston Olifantsfontein Soweto N17 / N1 N1 N17 N4 N17 N17 N4 N1 N3 R21 N1 N4 0 10 20 30 405 Kilometers I O.R Tambo International Airport W orkPacka ge B WorkPackageC WorkPackageG WorkPackageH Work Package D1 Work Package D3 Work Package D2 Work PackageJ Work Package I Work Pakage K Work PackageF Work Package E2 Work Pack ageE1 Work Pakage E3 W orkPackageA1 GFIP OVERVIEW •  The GFIP – A mul. package project. •  2008 to 2011/12. •  Major construc.on companies & some smaller en..es plus JVs. •  Roughly 27% increase in surface area. •  Thus 73% rehabilita.on of exis.ng road surface area. •  Some packages had more structural (bridge) work than others. •  Some packages had more interchange work than others.
  • 13.
    OUTA’S ANALYSIS: PACKAGEG “BASE CASE” •  Work Package “G” – R21 Olifantsfontein to Solomon Mahlangu –  (Solomon Mahlangu Interchange previously Hans Strydom) . •  OUTA obtained the full tender documents. •  17,6 km long: 2-lanes upgraded to 4-lanes (each way). •  Had highest ratio of new lane construction (38%) to re-habilitation (62%). Why not 50:50? Lanes not as wide... etc. •  Little structural work in this package. •  New lane construction is much more expensive than rehabilitation. Thus package “G” and “H” had higher road work elements than others.
  • 14.
    OUTA's WORK PACKAGE "G" COST CALCULATION (ZAR) SCHEDULE Package G TOTAL SCHEDULE B: Structures 16,508,420 TOTAL SCHEDULE D: Govt requirements for BBBEE1,040,000 TOTAL SCHEDULE E: Electrical 37,520,883 TOTAL SCHEDULE F: Ultra thin friction course 45,260,000 TOTAL SCHEDULE H: Alternative Road works 486,354,997 TOTAL SCHEDULES 586,684,300 Contract Price Adjustment 29,598,222 TOTAL (Excluding VAT) 616,282,522 ADD 14% VAT 86,279,553 TOTAL WORKPACKAGE COST 702,562,075 Length of the Work Package (km) 17.6 Ave. Cost / km (Including Lighting) 39,918,300 SANRAL's PAID TENDER 798,467,400 SANRAL's Cost per KM for Work Package 45,367,466 COST VARIANCE: Overpriced / (Underpriced) 95,905,325 PERCENTAGE VARIANCE 13.7% Package “G” Overview •  Applying Quan..es and indices as per tender docs & material / input costs. •  Tenders asked for cos.ng within & without more expensive UTCRCP (Ultra Thin Con.nuously Reinforced Concrete Paving ). •  The opinion without was used. •  Cost of Package G: R703 million •  Ave R40 mil / kilometer. •  A good base for other packages, excluding structural work. •  Lowest variance.
  • 15.
    OUTA’S ANALYSIS –METHODOLOGY 1 39,918,300 Work Package Project Description Distance (km) OUTA Indicative Amount (Incl VAT) SANRAL's Price Paid (Incl VAT) Value Variance % Variance A N1 - 20 (From Golden Highway to 14th Ave) N12 - 18 (From Uncle Charlies - Diepkloof) 18 718,529,400 1,413,571,487 695,042,087 97% B N1 - 20 (From 14th Avenue - Buccleuch) 21 838,284,300 2,183,752,221 1,345,467,921 161% C N1 - 20&21 (From Buccleuch - Brakfontein) 23 918,120,900 1,944,729,160 1,026,608,260 112% D1 N1 - 21 (From Brakfontein - Flying Saucer) 10 399,183,000 1,363,391,263 964,208,263 242% D2 N1 - 21 (Atterbury - Scientia) 5 199,591,500 776,885,235 577,293,735 289% D3 N1 - 21 (Flying Saucer - Atterbury) 6 239,509,800 330,609,234 91,099,434 38% E1 N3 - 12 (Heidelberg - Geldenhuys) 12 479,019,600 E2 N12 - 18 (From Reading - Elands) 4 159,673,200 E3 N12 - 18 (Uncle Charlies - Reading) 12 479,019,600 661,518,487 182,498,887 38% F N3 - 12 (Geldenhuys - Buccleuch) 18 718,529,400 1,498,076,241 779,546,841 108% G R21 - 2 (Olifantsfontein - Hans Strydom) 17.6 702,562,080 798,467,400 95,905,320 14% H R21 - 1 (Benoni - Olifantsfontein) 12 479,019,600 677,530,023 198,510,423 41% I N12 - 19 (Gillooly's - Rietfontein) 10 399,183,000 1,399,103,587 999,920,587 250% J R21 - 1 (Rietfontein - Pomona) 5 199,591,500 436,394,880 236,803,380 119% K N12 - 19 (Rietfontein - Tom Jones) 9.5 379,223,850 862,603,256 483,379,406 127% ? Tom Jones - Putfontein 6 239,509,800 639,700,791 400,190,991 167% ? Pomona to Benoni 4 159,673,200 91,710,002 - 67,963,198 -43% 193 7,708,223,730 17,500,119,886 9,791,896,156 127% Precast Concrete Barriers (Tender 1) 278,024,278 278,024,278 - Precast Concrete Barriers (Tender 2) 105,743,928 105,743,928 - 8,091,991,936 17,883,888,092 9,791,896,156 121% 127 TOTAL with Barriers (19 Projects) Median Barriers Using Work Package G as a "Base Case" / km cost for G: METHODOLOGY 1 2,422,076,616 1,783,383,816 279% TOTAL without median barriers (17 Projects)
  • 16.
  • 17.
    SLIDE 13: SANRAL’SKEY QUANTITIES PACKAGES: A (1&2), B, C, D(1&2) E(1&2) F D1 D2 C F A1-A2 B E1 E2 Brakfontein to N1/R21 I/C Atterbury to Proefplaas Buccleuch to Brakfontein Geldenhuis to Buccleuch 14th Avenue to Uncle Charlies 14th Avenue to Buccleuch Old Barn to Geldenhuis Reading to Elands I/C Section 2200 Concrete 670.00 m3 195.00 m3 1930.00 m3 180.00 m3 312.00 m3 750.00 m3 336.00 m3 825.00 m3 5198.00 m3 Prefabricated Culverts Reinforcing 15.50 t 13.00 t 35.00 t 25.00 t 8.90 t 10.00 t 22.40 t 9.20 t 139.00 t Section 2300 Concrete 2620.00 m3 2510.00 m3 280.00 m3 4495.00 m3 5785.00 m3 11740.00 m3 1540.00 m3 2125.00 m3 31095.00 m3 Open Drains Reinforcing 48.40 t 37.00 t 2.50 t 61.60 t 13.50 t 134.00 t 53.00 t 41.50 t 391.50 t Section 4100 Prime Prime 160000.00 l 180000.00 l 424400.00 l 24360.00 l 241840.00 l 147000.00 l 77000.00 l 60000.00 l 1314600.00 l Tack Coat 30% Stable Grade Emulsion 310000.00 l 93600.00 l 1150000.00 l 562342.00 l 424225.00 l 156000.00 l 840000.00 l 140000.00 l 3676167.00 l Semi Gap 19mm max AR1 6640.00 t 6640.00 t Base 40/50 pen bit. With 26.5mm 159450.00 t 11986.00 t 17320.50 t 64045.00 t 35200.00 t 4221.67 t 292223.17 t Continuously Graded 30950.00 t 12130.00 t 26488.00 t 9239.00 t 1180.00 t 44000.00 t 89000.00 t 2875.00 t 215862.00 t Semi open grade bitumen rubber 12510.00 t 79000.00 t 16700.00 t 108210.00 t Concrete 20391.00 m3 9724.00 m3 32212.00 m3 12672.00 m3 5856.00 m3 26508.50 m3 15962.30 m3 16329.00 m3 139654.80 m3 Reinforcing 2876.50 t 1359.00 t 3874.00 t 1579.10 t 1568.10 t 4514.20 t 1792.35 t 2814.60 t 20377.85 t Section 7100 Concrete 5750.00 m3 3075.00 m3 29036.00 m3 16978.00 m3 7623.00 m3 30362.00 m3 1138.00 m3 93962.00 m3 Concrete Pavement Reinforcing 400.00 t 270.00 t 1504.00 t 50055.00 t 22.10 t 550.00 t 254.00 t 53055.10 t BRASO 20831.00 t 116920.00 t 36020.00 t 173771.00 t UTFC 50000.00 m2 50000.00 m2 Structures Section 4200 Asphalt GAUTENG TOLL HIGHWAY PROJECTS Total Total Concrete 269909.80 m3 Total Reinforcing 73963.45 t Total Prime 1314600.00 l Total Tack Coat 3676167.00 l Total Asphalt 796706.17 t Total UTFC 50000.00 m2
  • 18.
    OUTA’S ANALYSIS –METHODOLOGY 2A •  OUTA’s road construction engineers and QS applied their analysis of this information to:- –  these key quantities, –  length and width of road surface areas –  Understanding of higher extent of structural & bridgework on these packages. –  Applied known costs of material applicable at the time. –  Adjusted for COLTO standards, P&Gs, Series 3000 (Earthworks) etc. –  Applied their extensive construction experience. •  Added insights of another presentation by KAS JV on Work Package E1. •  Excluded Work Package F – Steel to Concrete ratio questionable.
  • 19.
    OUTA’S ANALYSIS –METHODOLOGY 2A OUTA's Calculation of Methodolgy 2(a) for Cost of GFIP: Work Packages A, B, B, D(1&2), E(1&2) and G SCHEDULE Package G Package A Package B Package C Package D1&2 Structures 16,508,420 49,428,973 189,003,552 202,648,672 146,498,436 Govt requirements for BBBEE 1,040,000 1,216,108 1,387,070 1,817,169 1,817,169 Electrical and lighting 37,520,883 23,356,721 27,249,508 29,844,699 19,463,934 BRASO/ UTFC/ Other layers 45,260,000 184,161,777 88,446,763 51,150,320 75,248,898 Road works 486,354,997 338,597,160 395,030,020 558,340,722 391,130,053 TOTAL SCHEDULES 586,684,300 596,760,739 701,116,912 843,801,582 634,158,490 Contract Price Adjustment 29,598,222.93 25,951,632.63 51,220,972.44 39,458,974.62 29,464,315.48 TOTAL with CPA 616,282,522.49 622,712,371.47 752,337,884.78 883,260,556.16 663,622,805.03 ADD 14% VAT 86,279,553 87,179,732 105,327,304 123,656,478 92,907,193 TOTAL WORKPACKAGE COST 702,562,076 709,892,103 857,665,189 1,006,917,034 756,529,998 Length of the Work Package (km) 18 18 21 23 15 Ave. Cost / km (Including Structures & Lighting) 39,918,300 39,438,450 40,841,199 43,779,001 50,435,333 SANRAL's PAID TENDER 798,467,400 1,413,571,487 2,183,752,221 1,944,729,160 2,140,276,499 SANRAL's Cost per KM for Work Package 45,367,466 78,531,749 103,988,201 84,553,442 142,685,100 COST VARIANCE: Overpriced / (Underpriced) 95,905,324 703,679,384 1,326,087,033 937,812,126 1,383,746,501 PERCENTAGE VARIANCE 14% 99% 155% 93% 183% Package E1 + E2 Total 133,485,246 737,573,300 1,511,532 8,789,047 26,281,529 163,717,273 187,955,400 632,223,157 468,435,544 2,637,888,496 817,669,251 4,180,191,273 39,229,953.62 214,924,072 856,899,204.96 4,395,115,345 119,965,889 615,316,148 976,865,094 5,010,431,493 16 111 61,054,068 45,302,274 - 2,422,076,616 10,902,873,384 151,379,788 98,579,325 - 1,445,211,522 5,892,441,890 148% 118% OVER PRICED
  • 20.
    OUTA’S ANALYSIS –ROAD WORKS EST. ONLY•  Road Works estimate only for Packages A-E & G •  Cost / KM basis - 20,000,000 40,000,000 60,000,000 80,000,000 100,000,000 120,000,000 140,000,000 1 2 3 4 5 6 7 Work Package Cost per KM for Road works * RANDS OUTA’s Es<mate Cost / KM SANRAL Cost / KM ** * ROAD WORKS Costs are those a3ributed to all work, less structures, CPA and VAT ** Note: Sanral’s figures are their own, pre CPA and less OUTA’s esGmate of Structure costs. All excl. VAT Work Packages > A B C D 1&2 AVE (A,B,C,D,E,G) G E 1&2 OUTA: R31,1 m SANRAL: R86,6 m
  • 21.
    OUTA’S ANALYSIS –METHODOLOGY 2B More Accurate Approach •  Using 2(a) methodology for 111 km of packages with good costing information. •  Combined with Package “G” base case for remainder 82 km packages, and inflating Structures costs. OUTA's Calculation of Methodolgy 2(b): TOTAL Cost of GFIPOUTA's Calculation of Methodolgy 2(b): TOTAL Cost of GFIP SCHEDULE Structures Govt requirements for BBBEE Electrical and lighting BRASO/ UTFC/ Other layers Road works TOTAL SCHEDULES Contract Price Adjustment TOTAL with CPA ADD 14% VAT WORKPACKAGE COST (Excl Barriers) Median Barriers (as per Sanral Tender) TOTAL COSTS (Inclu Median Barriers) Length of the Work Package (km) Ave. Cost / km (Including Structures & Lighting) SANRAL's PAID TENDER (Excl Barriers) Median Barriers (as per Sanral Tender) SANRALS TOTAL GFIP COSTS (Incl Barriers) SANRAL's Cost per KM for Work Package COST VARIANCE: Overpriced / (Underpriced) PERCENTAGE VARIANCE * Package G costs adjusted to increase allowance for Structures and Road Works OUTA's ESTIMATES SANRAL's COSTS VARIANCE Using Calculations for Methodology 2(a) Using Methodology 1 Work Packages A, B, C, D(1&2), E(1&2), G Ave G Costs* Applied to Remainder Packages GFIP TOTAL 737,573,300 277,289,421 1,014,862,721 8,789,047 4,869,091 13,658,138 163,717,273 175,665,950 339,383,223 632,223,157 211,899,091 844,122,248 2,637,888,496 2,077,025,668 4,714,914,164 4,180,191,273 2,746,749,221 6,926,940,494 214,924,072 138,573,498 353,497,570 4,395,115,345 2,885,322,719 7,280,438,064 615,316,148 403,945,181 1,019,261,329 5,010,431,493 3,289,267,900 8,299,699,393 383,768,206 8,683,467,599 111 82 193 45,302,274 39,918,300 44,992,060 - 10,902,873,384 6,597,246,503 17,500,119,886 383,768,206 17,883,888,092 98,579,325 80,063,671 92,662,633 - 5,892,441,890 3,307,978,603 9,200,420,494 118% 101% 106% * Package G costs adjusted to increase allowance for Structures and Road Works SANRAL PAID OVER PRICED BY
  • 22.
    OUTA’S ANALYSIS –METHODOLOGY 3 Square Meter Surface Calculations: Rehab & New •  Using combination of satellite imagery, tenders, & known information of road widths, OUTA estimated surface area of New and Existing Road Works. •  OUTA placed new road construction at R1666 / m2 •  Rehabilitation / resurfacing at average of R325 / m2 •  Then added earlier costing pertaining to Lighting, Structures, CPA etc. Methodology 3: Applying Cost / Sq M for Roadworks AREA (Sq M) COST (ZAR) AREA (Sq M) COST (ZAR) AREA (Sq M) COST (ZAR) New Road Surface Area 1,666R 1,182,720 1,970,411,520 761,223.84 1,268,198,919 1,943,944 3,238,610,439 Existing Road Surface Area 325R 3,193,440 1,037,868,000 2,055,366.16 667,994,002 5,248,806 1,705,862,002 TOTAL 4,376,160 3,008,279,520 2,816,590 1,936,192,921 7,192,750 4,944,472,441 Total per Sq M 687R Lighting 163,717,273 175,665,950.24 339383223 Structures 737,573,300 277,289,421 1,014,862,721 TOTAL 3,909,570,093 2,389,148,292 6,298,718,385 Remaining 82 km of GFIP AREA of A, B, C, D(1&2), E(1&2), & GCost / Sq M Applied TOTAL GFIP ITEMS COSTED CSI & BBBEE 8,789,047 4,869,090.91 13,658,138.11 Contract Price Adj 214,924,072 138,573,498.26 353,497,569.98 Median Barriers 383,768,205.78 TOTAL 4,133,283,212 2,532,590,881 7,049,642,299 VAT (@ 14%) 578,659,650 354,562,723 986,949,922 TOTAL Including VAT 1,117R 4,711,942,862 - 2,887,153,605 8,036,592,221 SANRAL PAID > 17,880,000,000 SANRAL's COST / Sq M: 2,486R 2,485.84
  • 23.
    SUMMARY OF OUTA’SANALYSIS 3 METHODOLOGIES VARIOUS ASSESSMENTS ALIGN •  Whichever way we look at it, we come in at around R8,3bn. •  OUTA realises that SANRAL will seek more flaws and errors to denounce our findings, analysis and claims. •  Which is why we now seek the actual and full information – in electronic format . •  Without excuses of secrecy due to privileged information etc. SUMMARY AND COMPARISONS OF OUTA's THREE CALCULATION METHODOLOGIES METHOD COST OF GFIP METHOD DESCRIPTION Method 1 8,091,991,936 Using Engineers calculation Package G tender documents as (base case) per KM for all packages Method 2(b) 8,683,467,599 Using Engineers calculation of Key Quantities obtained for Several Work Packages (A, B, C, D, E, G) and applying Package G (base case cost / KM) to remainder of packages (82km) Method 3 8,036,592,221 Applying the figure of R325/m² for rehabilitation work(5,248,806 m2) and R1666/m² for added surface area (1,943,944 m2) and adding costs pertaining to structures, lighting and median barriers. AVERAGE 8,270,683,918 Taking an average of the above three methodologies SANRAL 17,883,888,092 The actual figure paid by SANRAL for the GFIP DIFFERENCE 9,613,204,174 % Variance 116% The amount OUTA believe that SANRAL overpaid for the GFIP
  • 24.
    OUTA's ASSESSMENT OF WORK PACKAGE "I" SCHEDULE (Gillooly's to Rietfontein IC) Package I SANRAL's Cost of Work Package I (before CPA & VAT) 1,102,283,849 Estimate Structure Costs by OUTA (Maximum)150,000,000 OUTA's Est of SANRAL's Cost of Road works: (excluding Structures, CPA, VAT) 952,283,849 Length of Package: 10 Roadwork cost per KM (Excluding VAT & CPA): 95,228,385 OUTA's Estimate of Road Work per KM: (Adjusted for higher cost of Ultra Thin Continuously Concrete Technology applied) 32,500,000 Overpricing of Work Package I per KM: 62,728,385 % Variance: 193% MORE ANOMOLIES: WORK PACKAGE “I” WORK PACKAGE I •  A simple route: Gillooly’s to Rietfontein. •  10 KM long with limited interchange work. •  Infrastructure work (Flyover and minimal bridge work) estimated at R150m. •  SANRAL paid R1,4 bn for this package. •  Excluding CPA and VAT, and less Structures estimate: SANRAL paid R952m. •  That is R95m / km for Road Work !!!! •  OUTA estimates 193% overpaid for road works
  • 25.
    CONTRACT PRICE ADJUSTMENT(CPA) Contract Price Adjustments (CPA) on GFIP •  CPA a standard adjustment, based on escalation indices provided by StatsSA monthly. •  Accounts for uncontrollable fluctuations (Fuel, Steel, Bitumen etc) are credited (or debited) •  Naturally, the higher the price of project, the higher the value of CPA. •  OUTA’s GFIP costs, applied to the actual CPA indicies = R215 m due to CPA (limited packages) •  SANRAL’s high costs of GFIP and apparent inflated CPA = 450% higher. •  OUTA estimates on total Package, SANRAL may have overcompensated contractors by over R1bn. Work Package SANRAL Paid OUTA Calculations % Variance A 122,880,404 25,951,632 373% B 239,656,005 51,220,972 368% C 213,424,406 39,458,975 441% D1 D2 E1 E2 G 69,410,000 29,598,222 135% TOTAL 1,181,168,640 214,924,071 450% Contract Price Adjustment on GFIP (limited packages) 300,913,065 29,464,316 39,229,954 697% 667% 234,884,760
  • 26.
    BENCHMARKING IN AFRICA ETHIOPIA:ADDIS ABABA to ADAMA Expressway •  Completed 2014. •  Greenfields project – 6 new lanes (3 each way). •  84 KM plus 18km link roads, 7,2 km front roads. •  Area: 2,625,700 m2 •  Rand Value: R4,1 billion (2008). •  Cost / km: R47,4 m •  Cost / m2: R1,541 •  COMPARED TO GFIP: R2,486 / m2
  • 27.
    BENCHMARKING IN USA KATYFreeway – Houston Texas •  Completed 2006, Widening - 22 lanes •  Bridge structures upgraded, rail line relocated •  Cost / m2: R1,359. GFIP: R2,486
  • 28.
    OTHER BENCHMARK PROJECTS BENCHMARKEXERCISE TO COMPARE GFIP ON COST / KM or m2 BASIS Benchmark Ref # 7: Project Name: Addis Ababa–Adama Expressway Year KM m² Value ($) (2014) Value ($) (2008) Value (ZAR)** Cost ZAR/km Cost ZAR/m² 2014 84.7 2,625,700 700,000,000 493,472,378 4,046,473,500 47,774,185 1,541 Benchmark Ref #8: Project Name: Nairobi-Thika Superhighway Upgrade Year KM m² Value ($) (2012) Value ($) (2008) Value (ZAR)** Cost ZAR/km Cost ZAR/m² 2012 50 1,700,000 360,000,000 285,153,719 2,338,260,496 46,765,210 1,375 Benchmark Ref # 9: Project Name: Tonota to Francistown Year KM m² Value ($) (2014) Value ($) (2008) Value (ZAR)** Cost ZAR/km Cost ZAR/m² 2015 30 744,000 113,000,000 89,506,584 733,953,989 24,465,133 986 Benchmark Ref # 11: Project: The Katy Freeway (IH-10) Year KM m² Value ($) (2006) Value ($) (2008) Value (ZAR)** Cost ZAR/km Cost ZAR/m² 2006 11.1 1,409,700 208,000,000 233,708,800 1,916,412,160 172,649,744 1,359 Benchmark Ref #12: Western Europe - Western China International Transit Corridor (CAREC - 1b) Year KM m² Value ($) (2006) Value ($) (2008) Value (ZAR)** Cost ZAR/km Cost ZAR/m² 2012 305 8,387,500 1,256,000,000 994,869,641 8,157,931,056 26,747,315 973 Benchmark Ref #13: PATHE - Section Maliakos - Kleidi Motorway PPP, Greece Year KM m² Value (€) (2012) Value (€) (2008) Value (ZAR)** Cost ZAR/km 2012 230 8,387,500 1,256,000,000 994,869,641 11,938,435,692 51,906,242 SANRAL's PRICE PAID FOR GFIP Year KM m² Value (ZAR)** Cost ZAR/km Cost ZAR/m² 2008 193 7,192,750 17,880,000,000 92,642,487 2,486 ** Deflated to 2008 Prices and R : $ Exchange rate at the time BENCHMARKING •  Always best to compare by M2 – if one can get the figure. •  Fine to do by KM if similar in width •  Try to compare similar type projects, eg. upgrade, widening etc. •  Convert to KM, Rands and Inflation. •  OUTA Research: Generally, other projects were more complex, had more new road works. •  We maintain that benchmarking with International projects (built to COLTO, FIDIC and World Bank standards) is an acceptable method of comparison. •  How else does one tell if local markets are being manipulated?
  • 29.
    TOO MANY QUESTIONS • SANRAL are the experts in this game – how did they allow such high pricing to prevail? •  Why did SANRAL not act faster to claw back the overcharges? •  Why is construction industry being “protected”? •  Why did CIDB halt its in-depth investigations into the matter? •  Why have SAFCEC and SAICE not taken SANRAL and the industry to task?
  • 30.
    CONCLUSIONS •  The GFIPPrice-tag of R17,9 bn is excessively overpriced. •  OUTA estimates value of between R8bn and R9bn (Less than ½ ). •  SANRAL has not been transparent and forthcoming with details and full explanations of how it arrived at R17,9bn. •  Information is missing on internet, when compared to other info. •  Even if OUTA has missed the mark by as much as 20%, the price-tag remains excessive. •  This issue will not abate until transparency and a full independent enquiry is commissioned.
  • 31.
    RECOMMENDATIONS •  OUTA willsend letters to relevant Ministers for request to intervene. •  OUTA will request that if SANRAL management is implicated or did not act in the best interests of the public: –  E-Tolls is scrapped forthwith. –  Corrective action is taken against ALL transgressors. •  The recent agreement between Government and Construction Industry players be revisited - as “punishment” imposed is hardly punitive. •  Civil claims are re-opened against construction industry for collusion and adequate penalties are applied.
  • 32.
    ...RECOMMENDATIONS •  That oversight& industry bodies explain why they have been silent on this issue. •  That the N3 Cedara – Durban project (and others) tenders are fully investigated: R15bn for a 78km upgrade project. •  That a Transport Regulator is introduced to monitor industry matters (An agreement was reached with The Road Freight Association that this would happen in 2012). •  That in conjunction with the introduction of a Transport Regulator, Government appoints an oversight body (that includes input from Civil Society) to monitor road construction pricing and tenders with the state.
  • 33.
