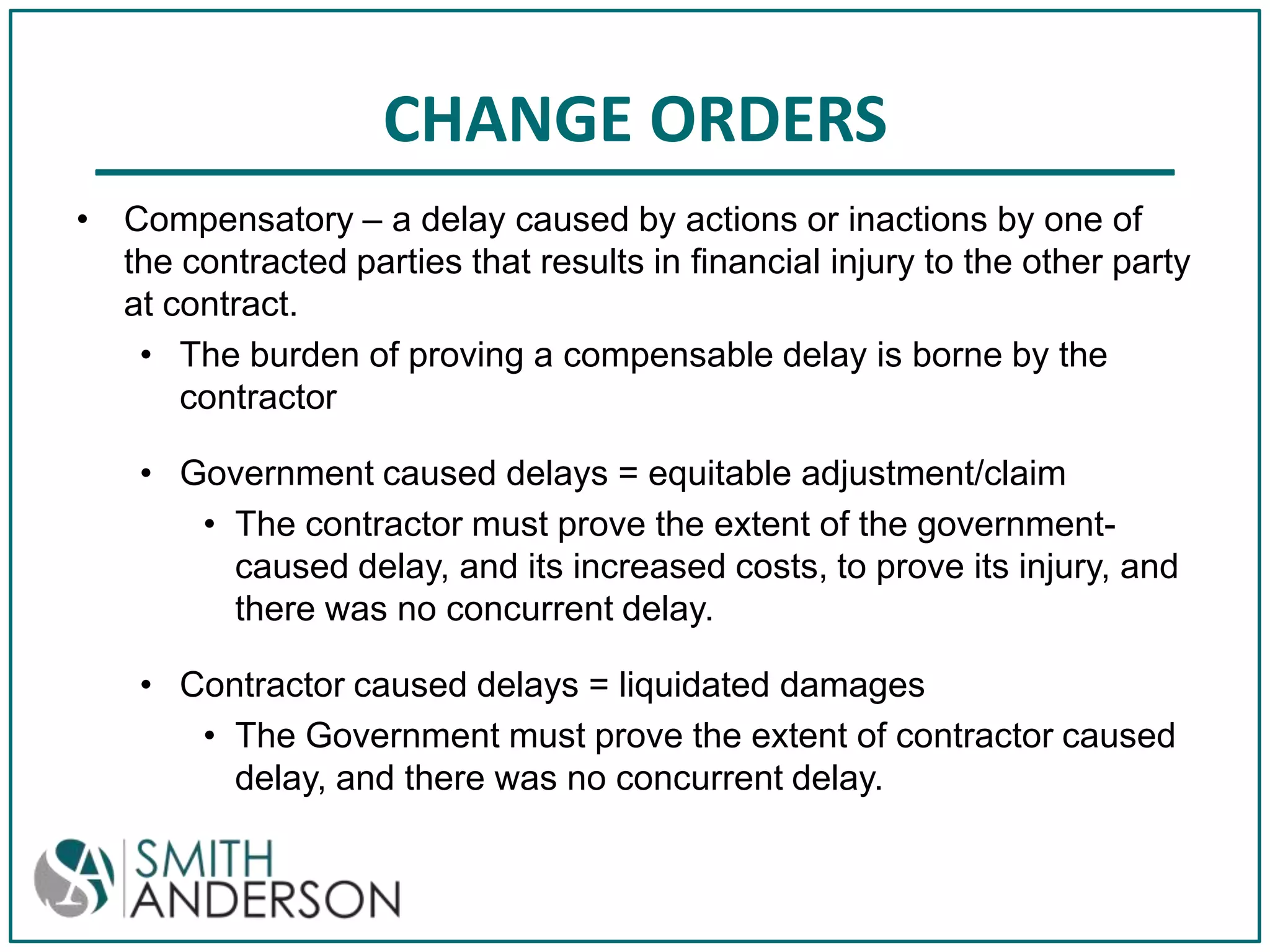

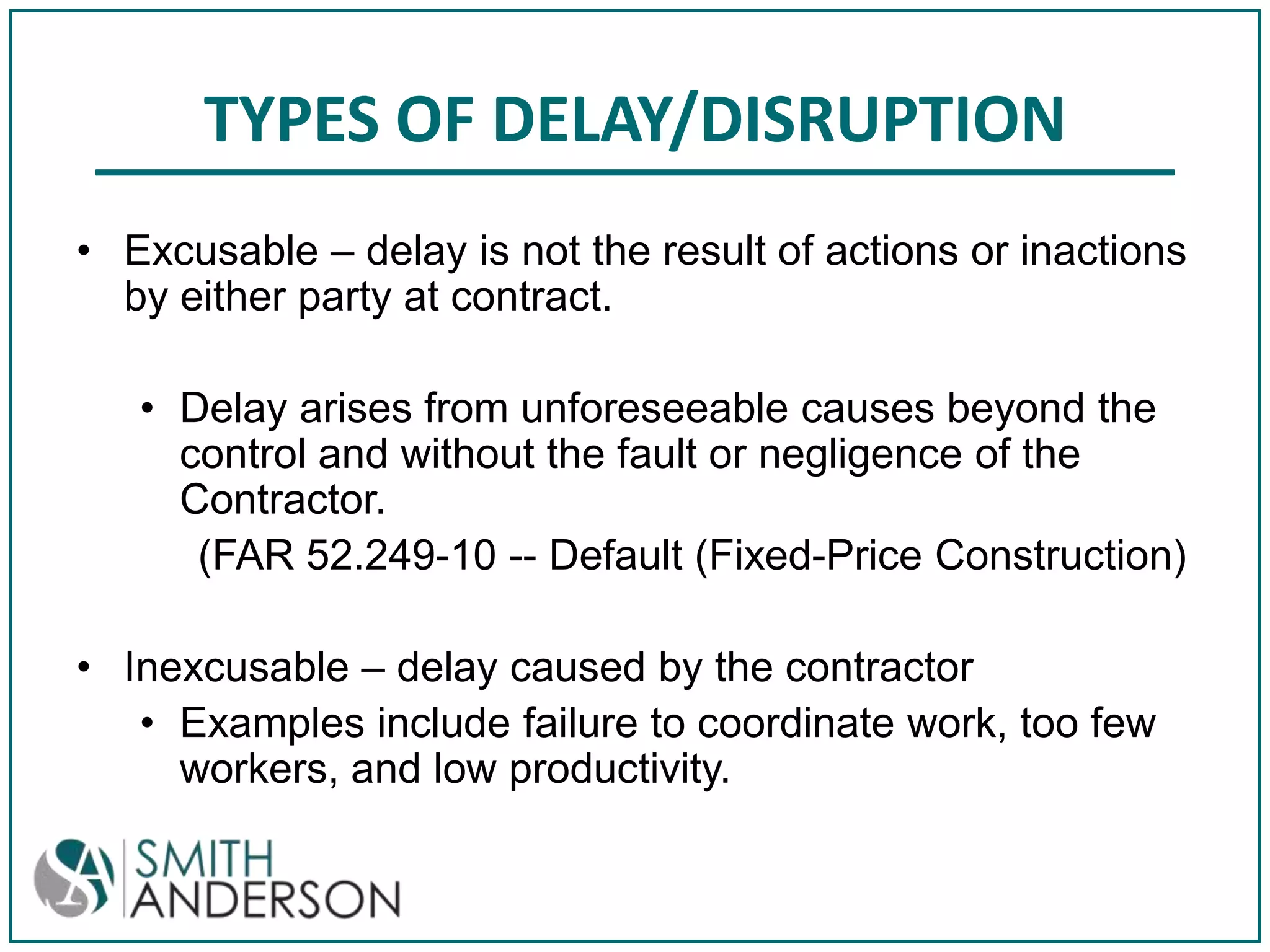

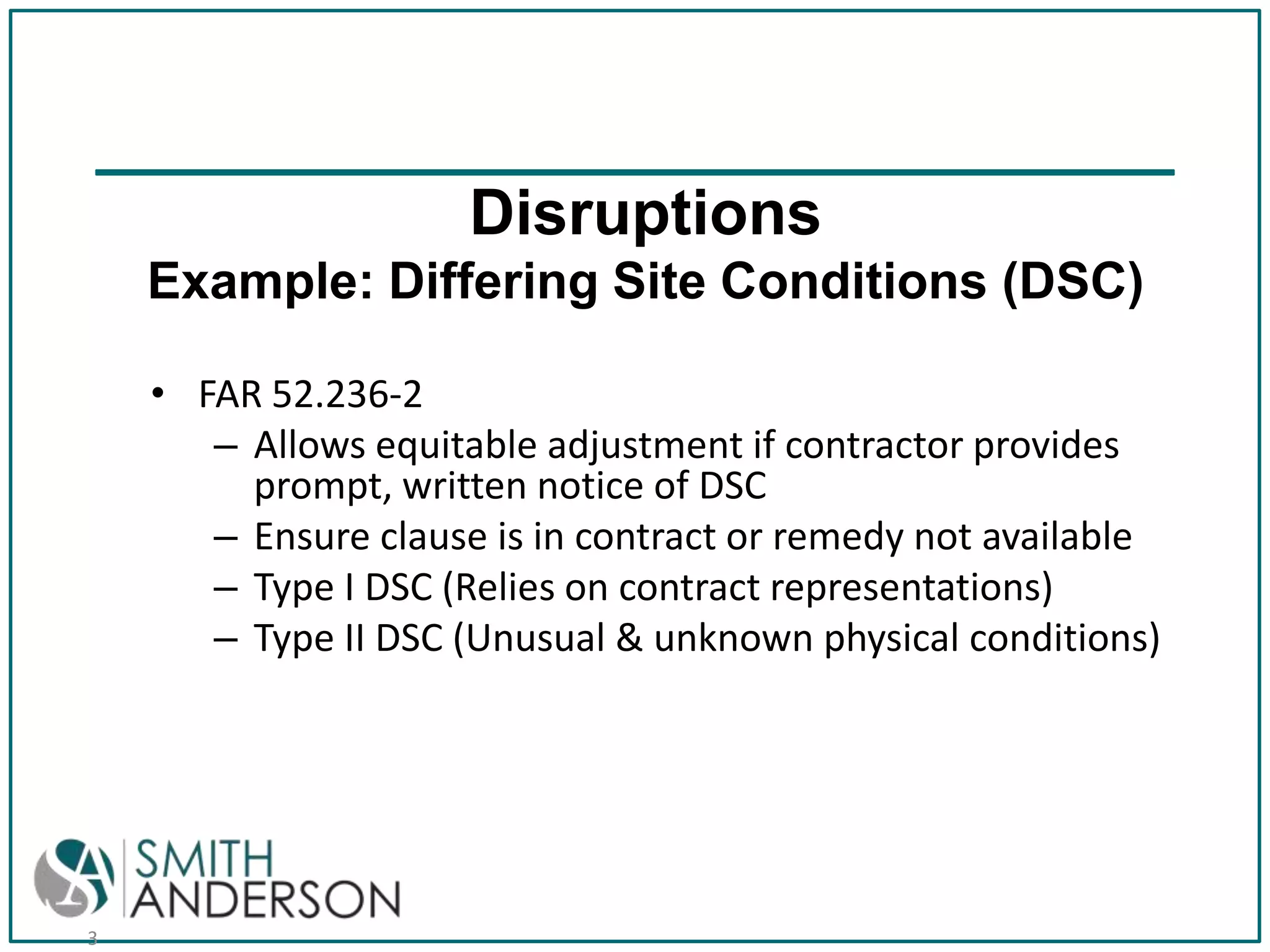

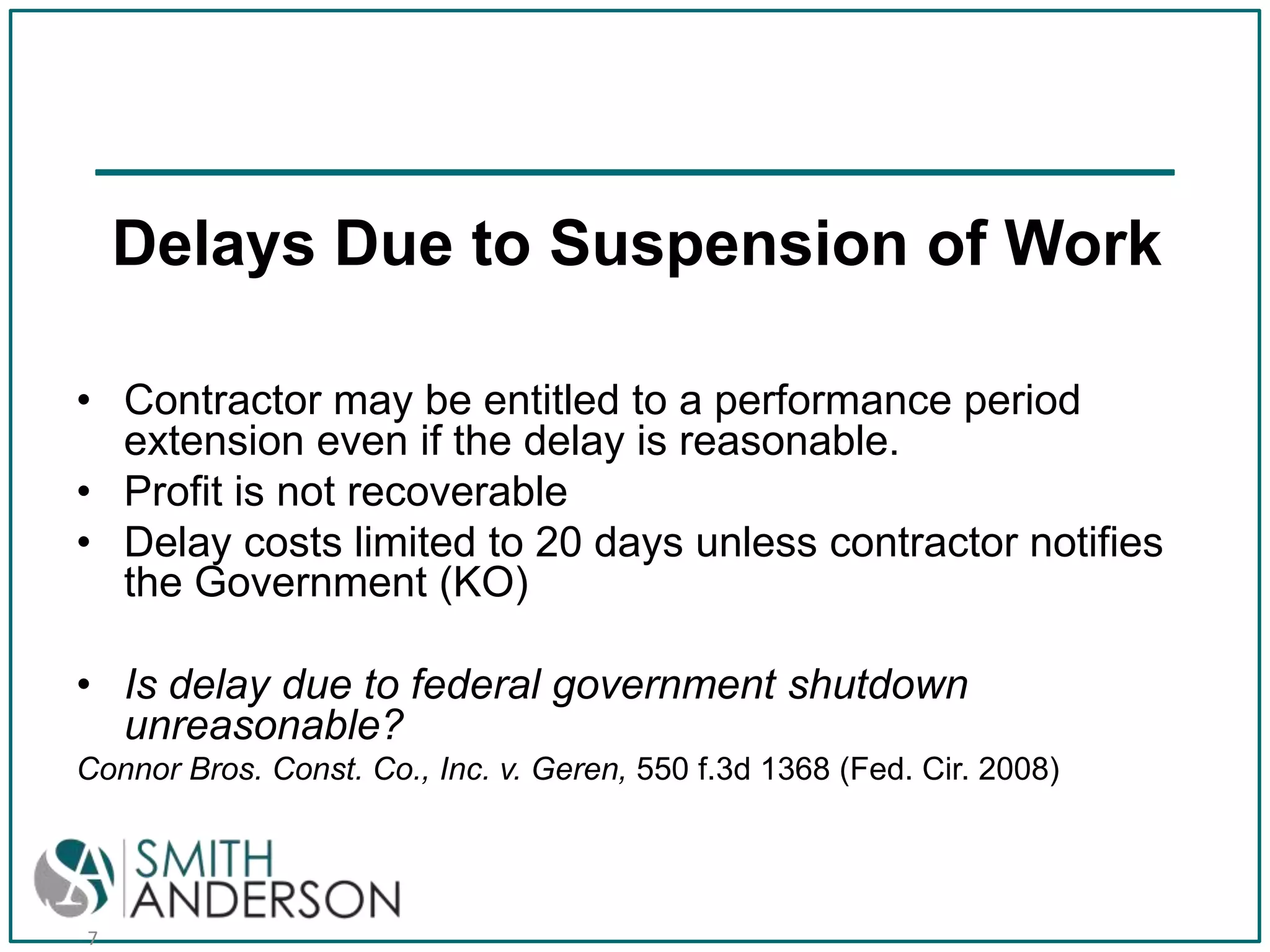

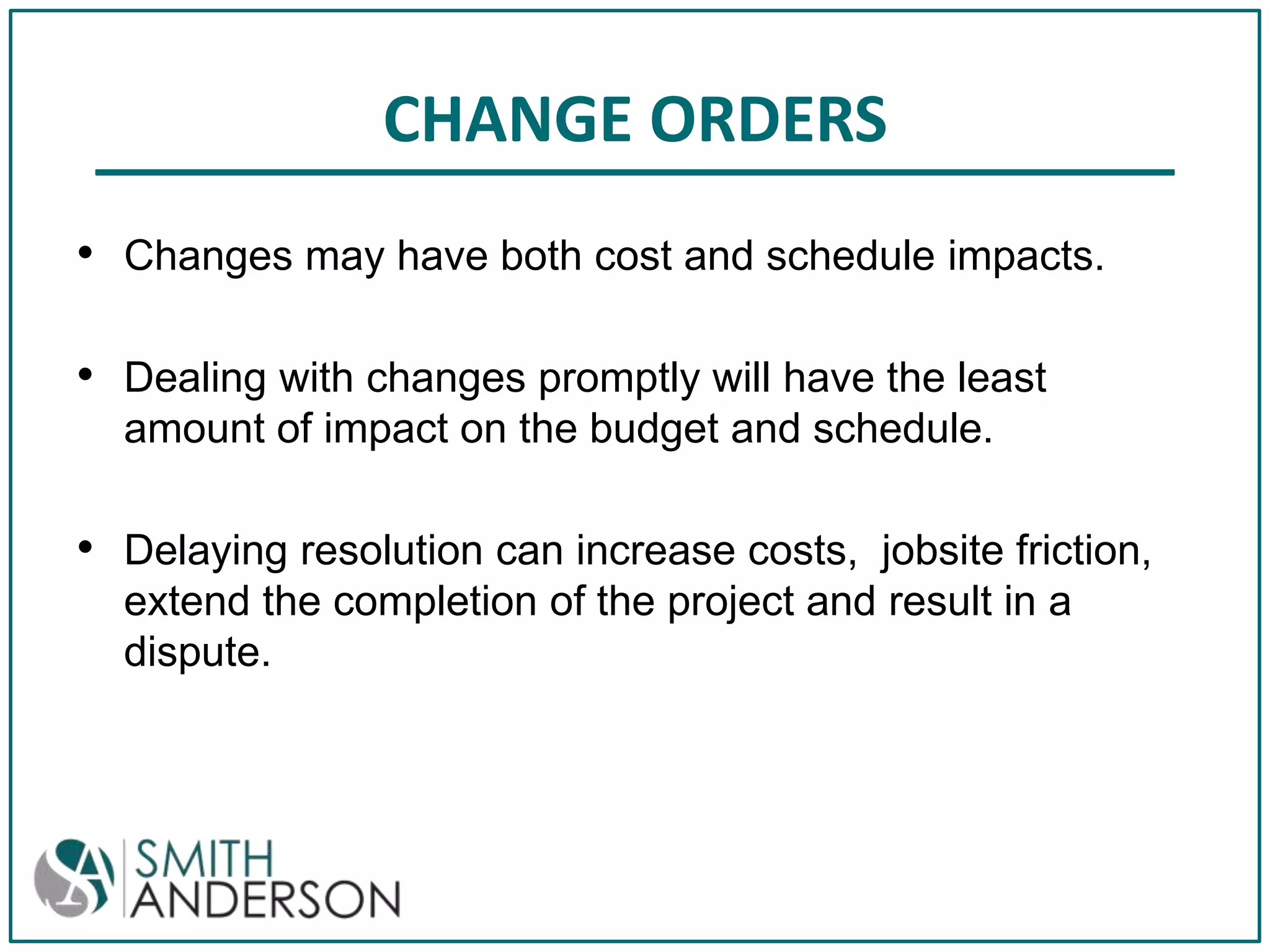

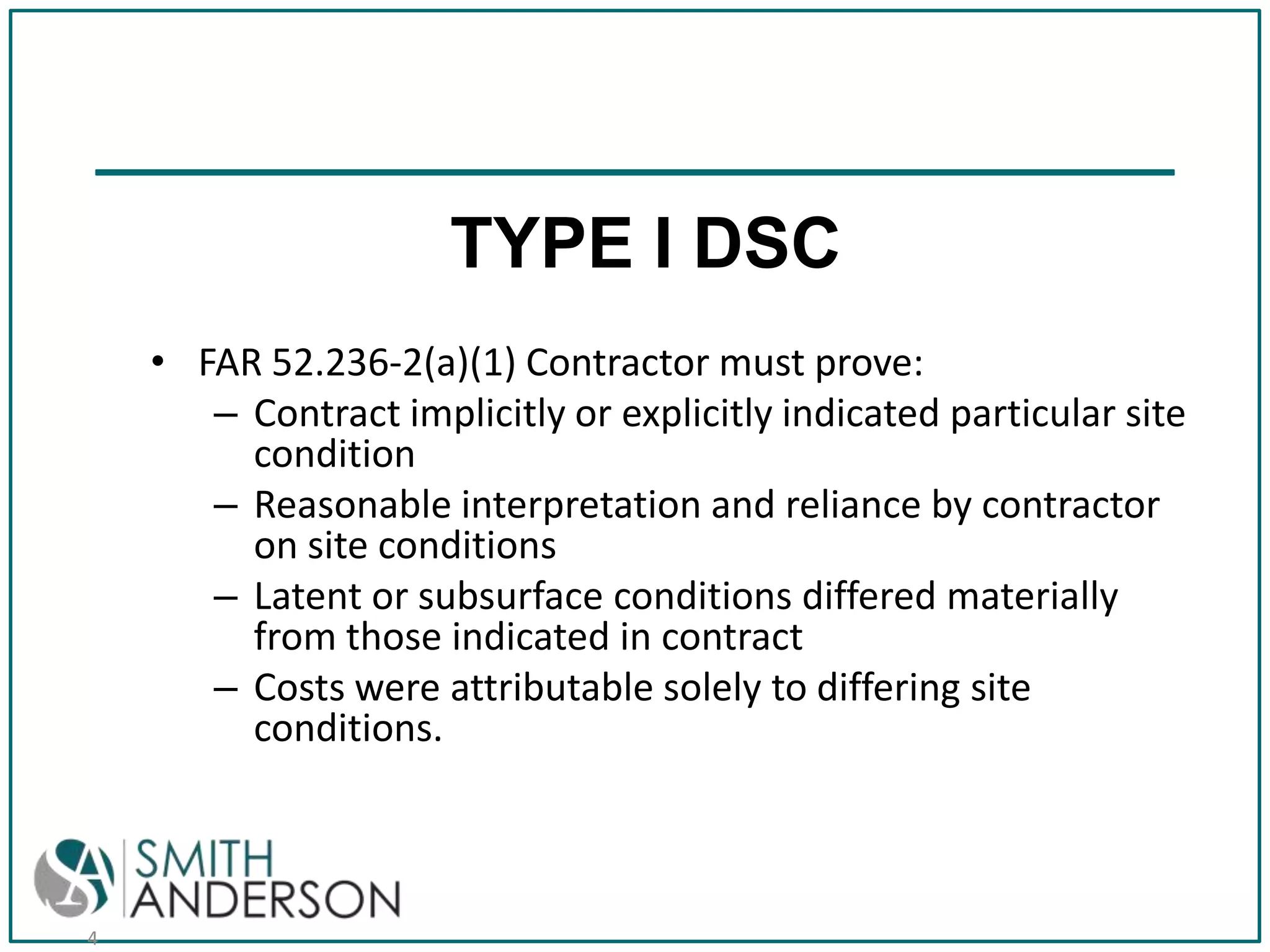

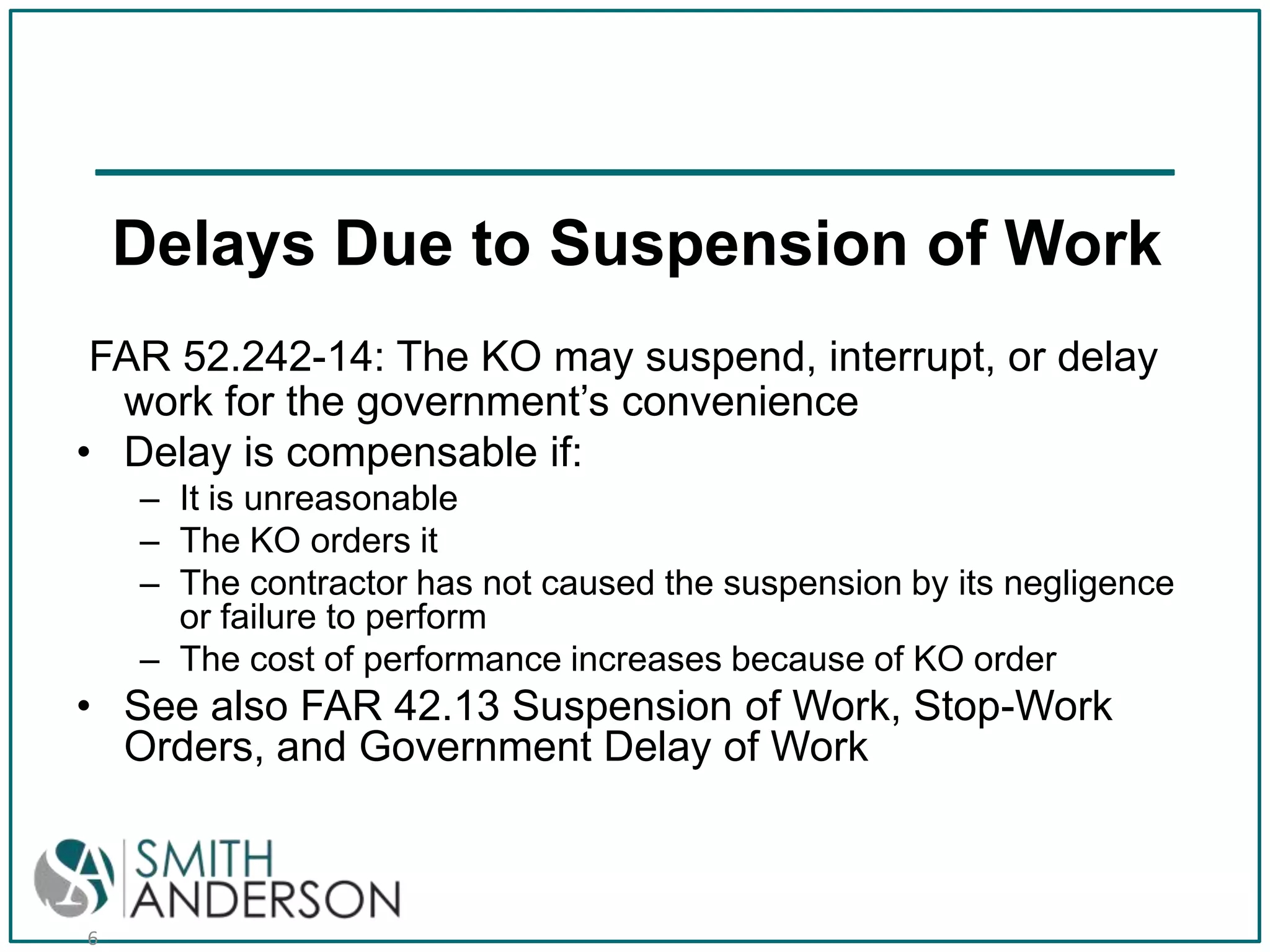

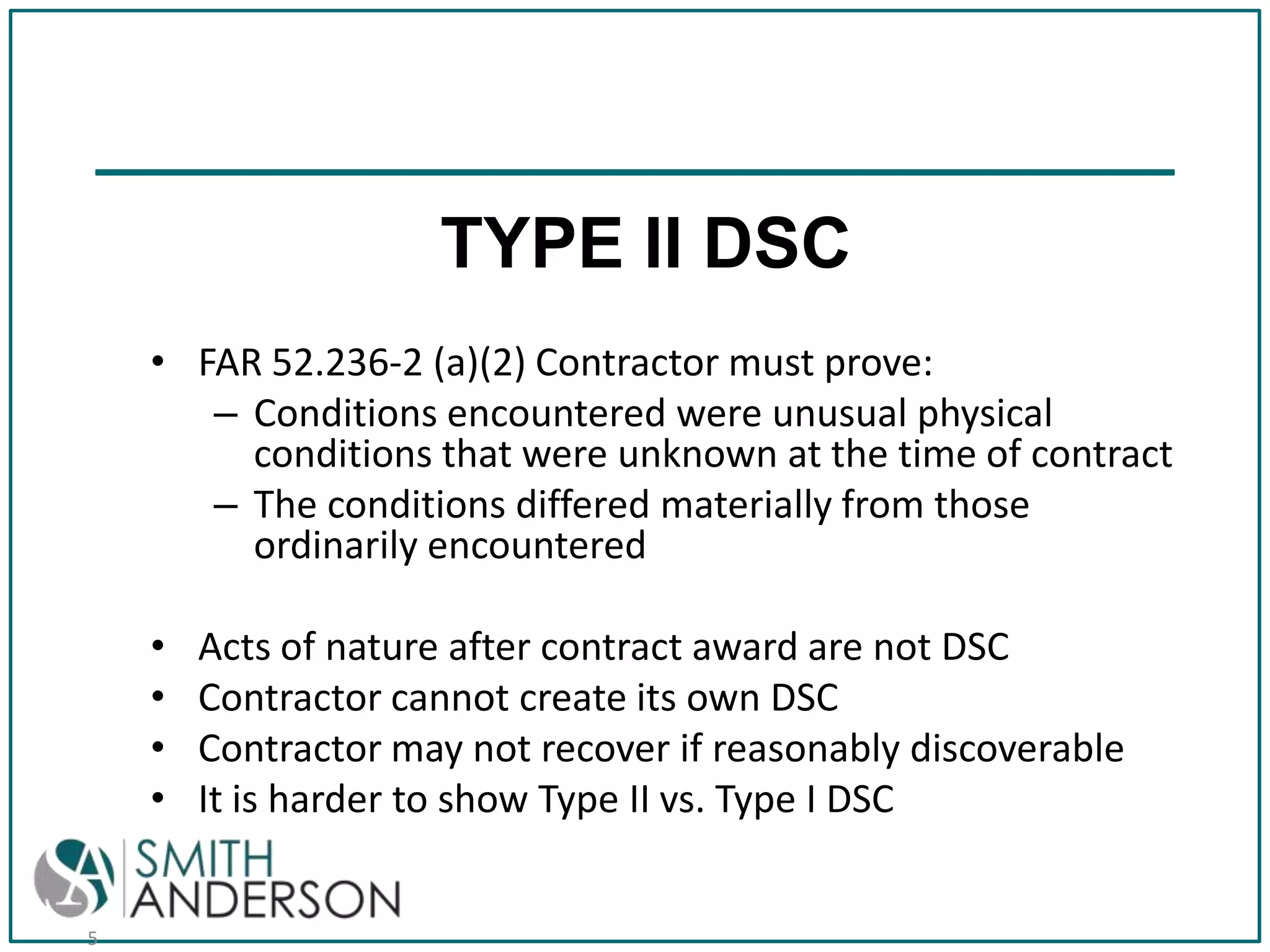

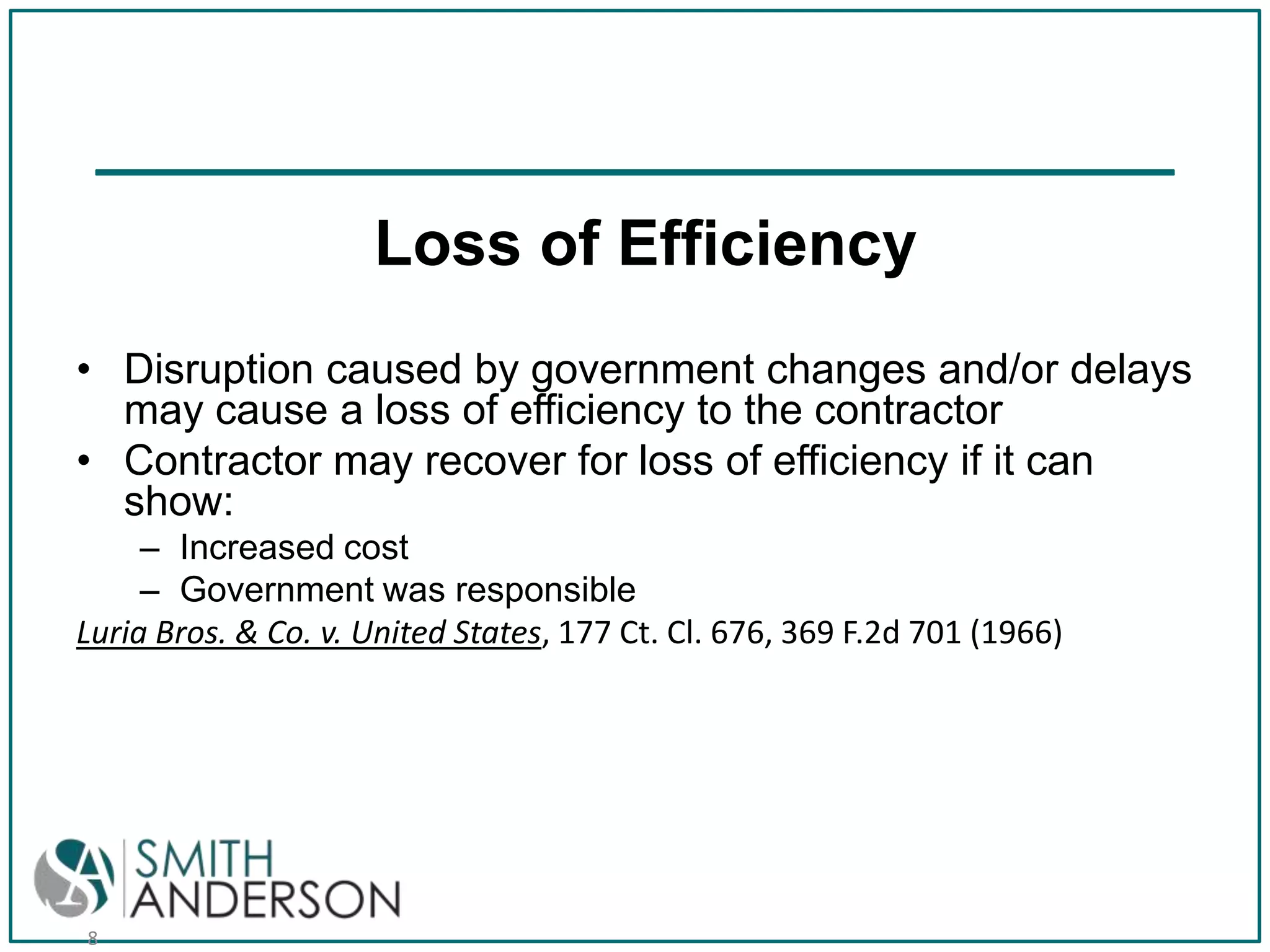

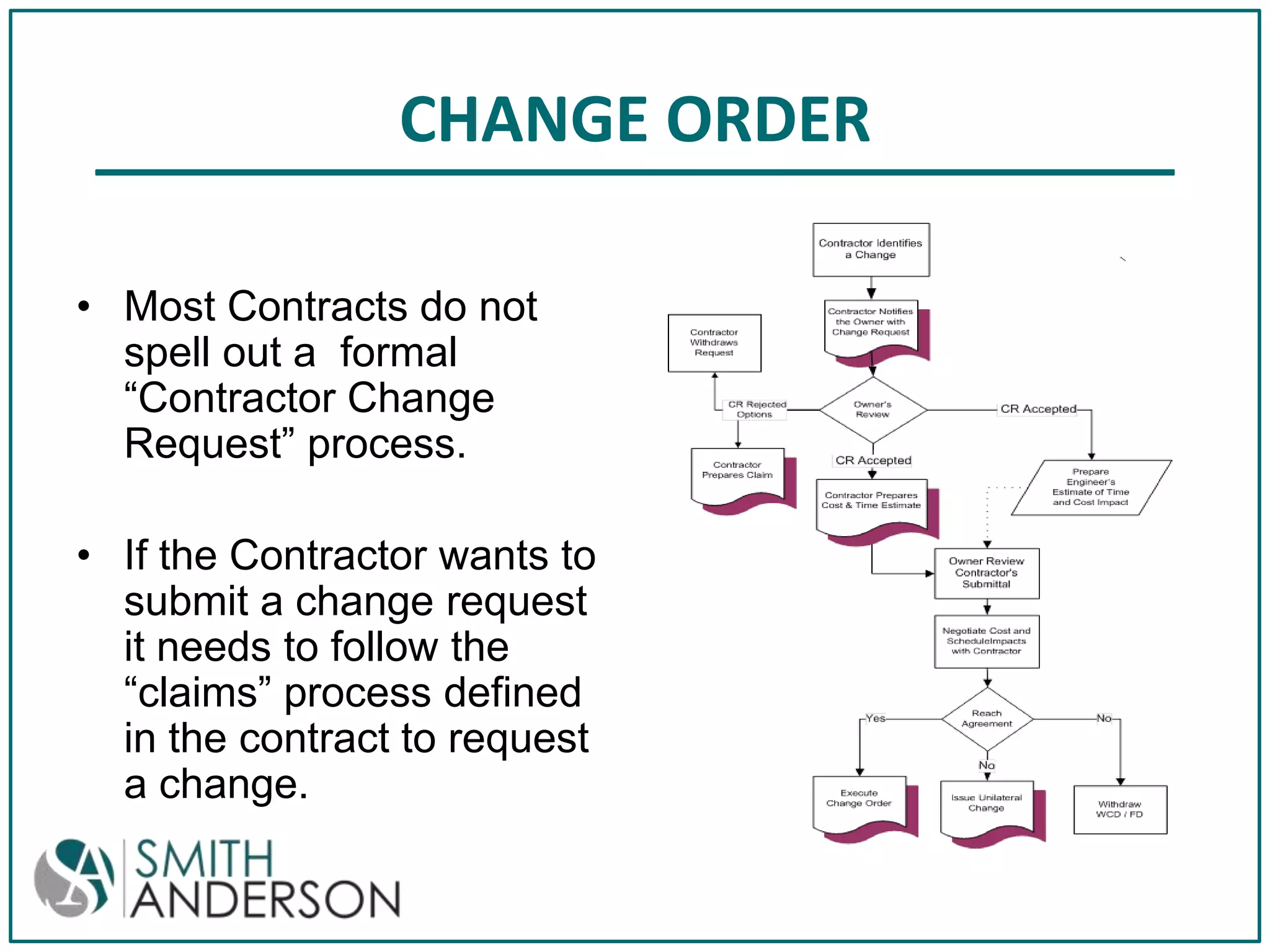

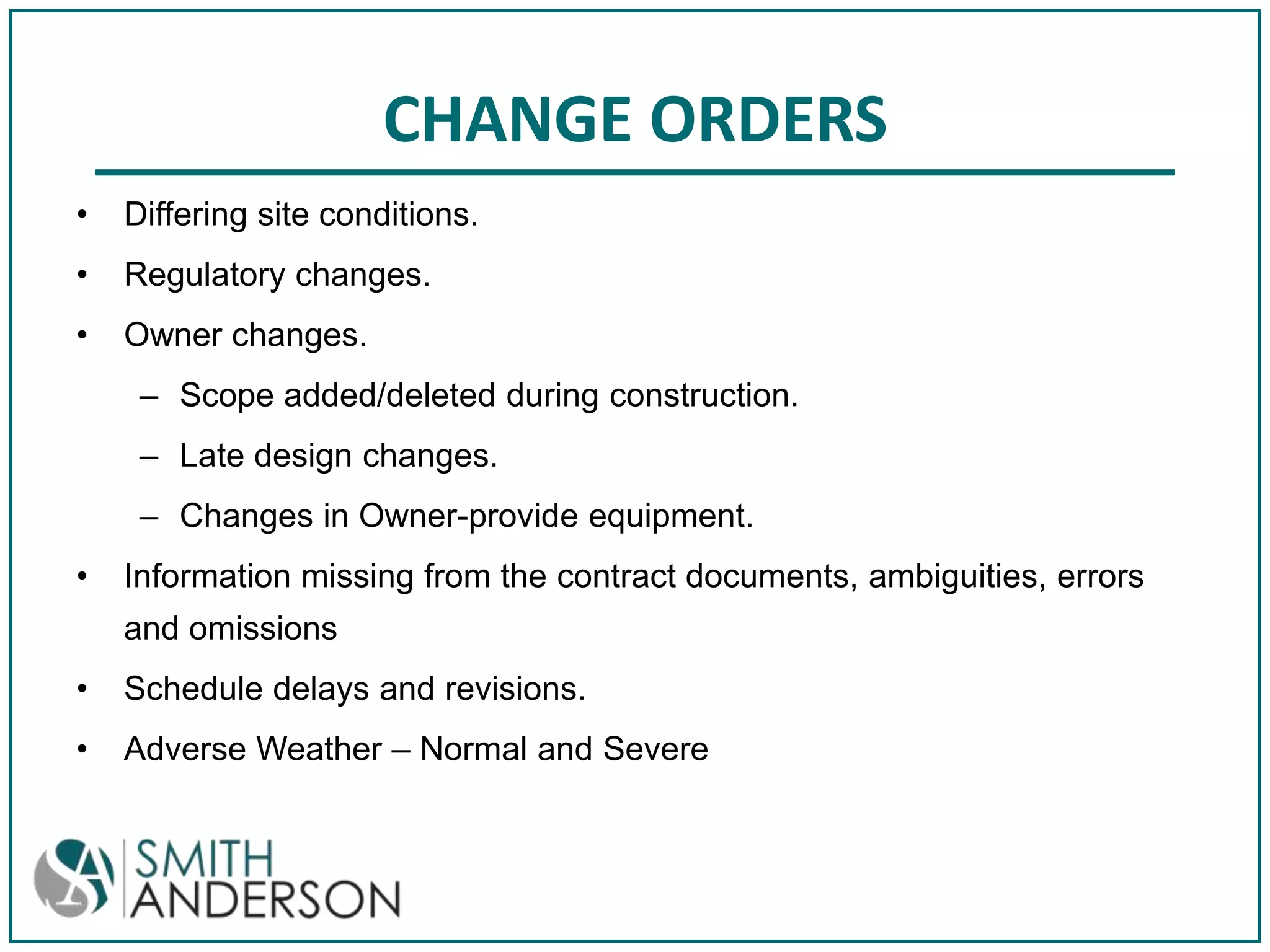

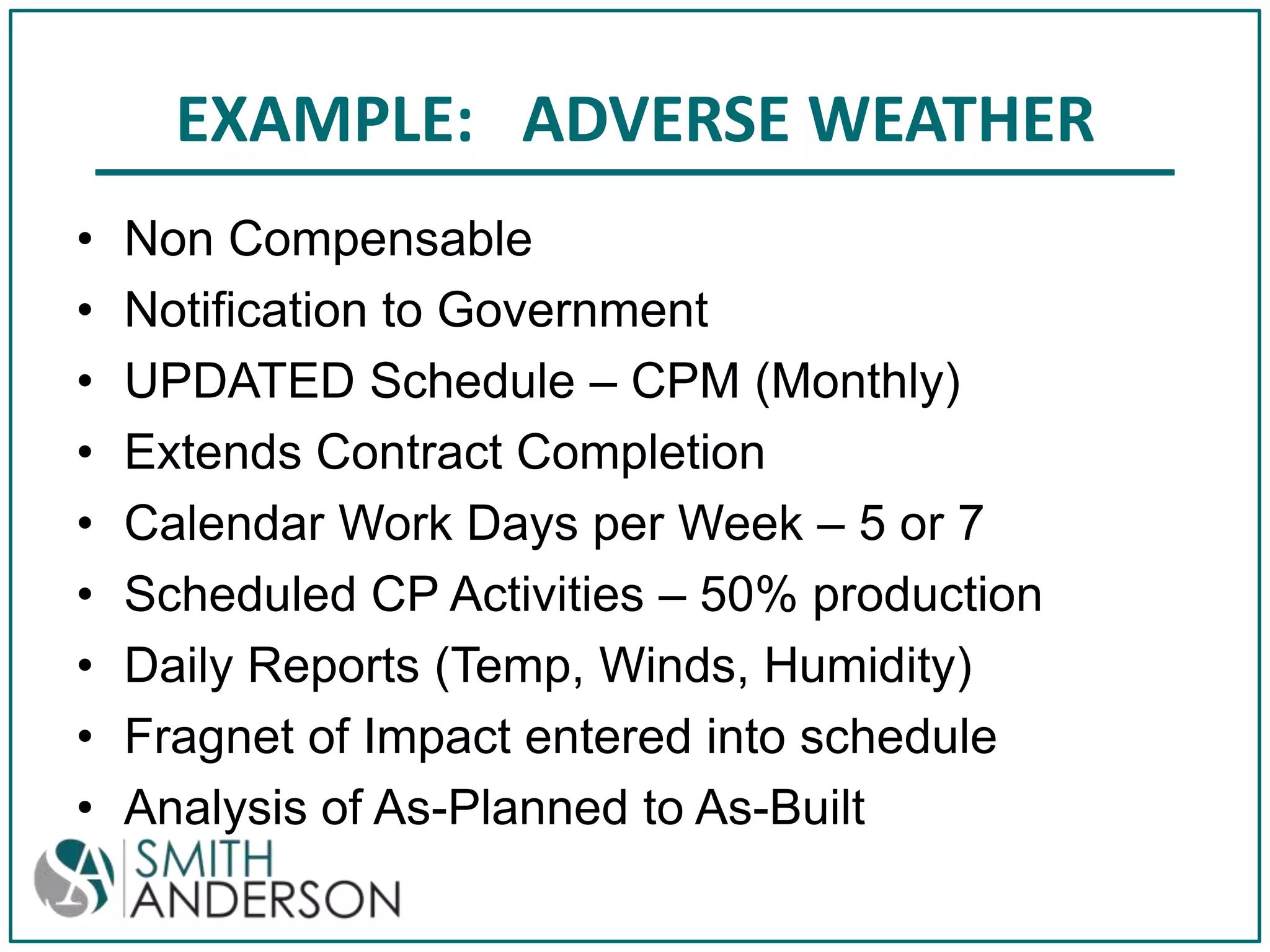

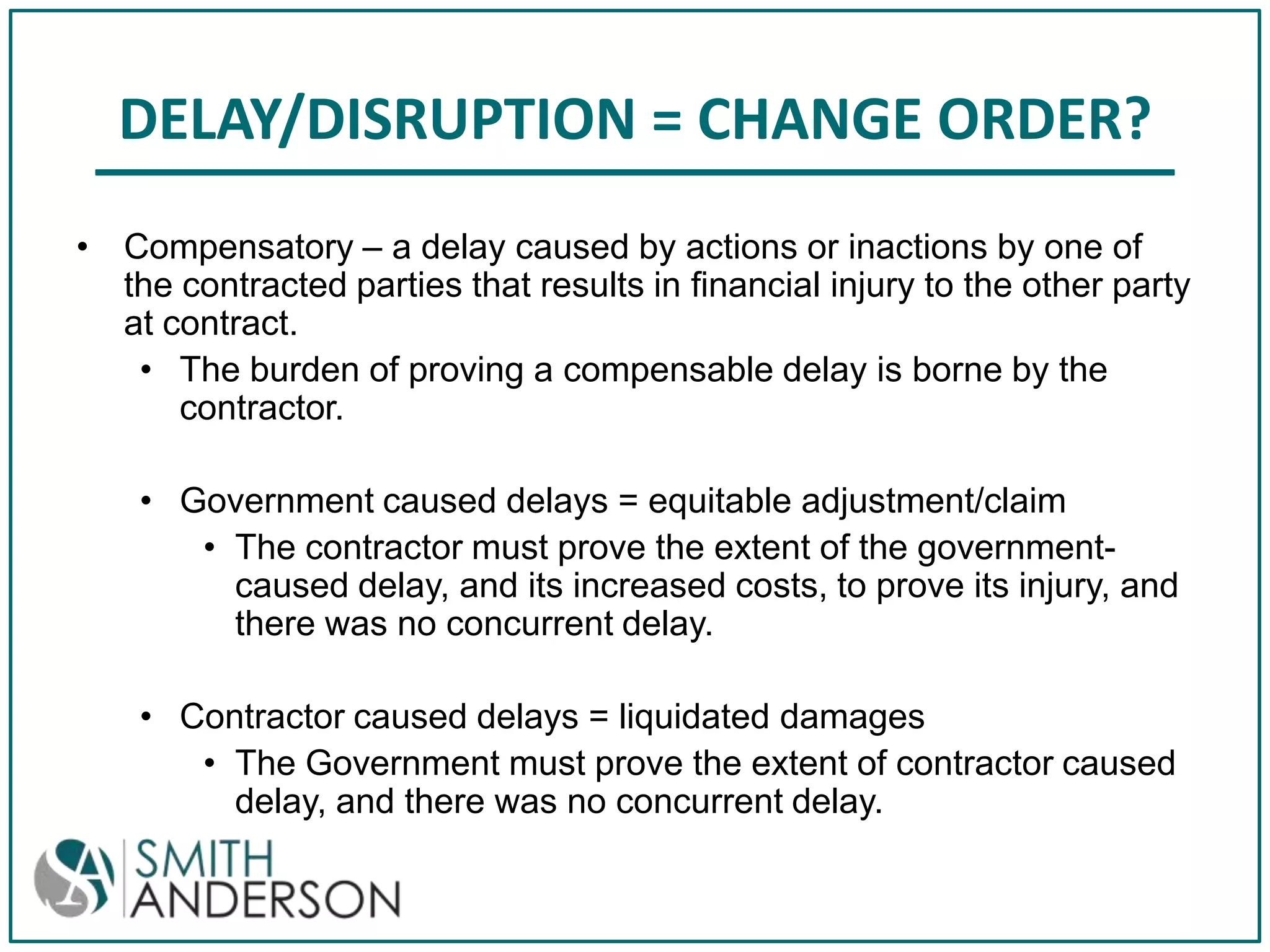

The document summarizes key topics around government contract disruptions, delays, and changes from a presentation given by David Hayden and Paulanne Page. It discusses differing site conditions, delays due to suspension of work, loss of efficiency claims, types of delays, and how delays and disruptions relate to change orders. It provides examples and requirements for contractors to receive compensation for type 1 and type 2 differing site conditions, suspension of work delays, and loss of efficiency claims. Contractors must prove the extent and cost of any government-caused impacts.
