Presented by:
Kent Brooks and Dallen Griffith
Casper Wyoming Community College
Gayle Jaacks, Ellucian
Sr. Project Manager, Ellucian
April 7, 2014
Session ID 1610
Seven Colleges’
Journey to one
Statewide Reporting
System

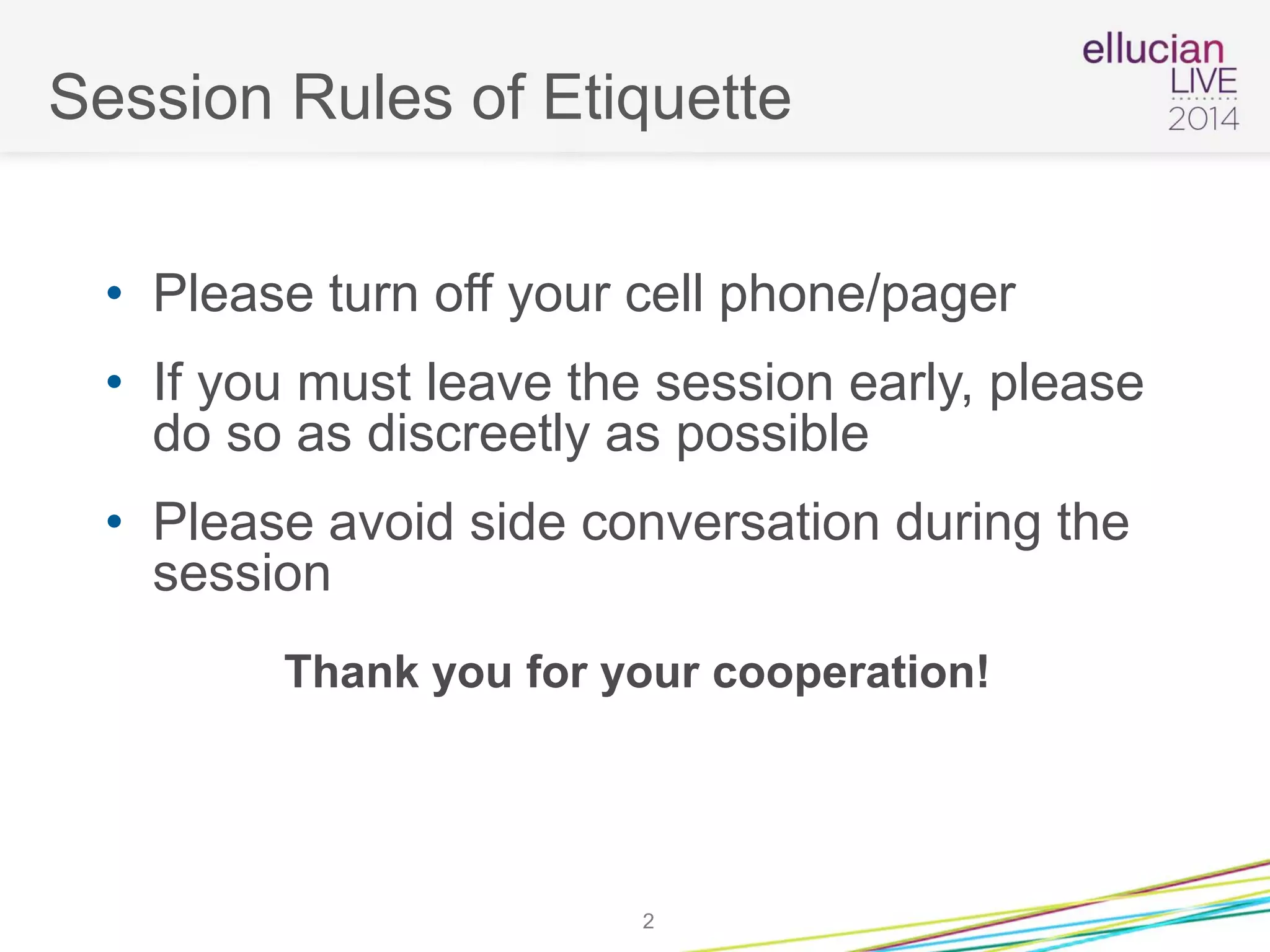

Session Rules of Etiquette
• Please turn off your cell phone/pager
• If you must leave the session early, please
do so as discreetly as possible
• Please avoid side conversation during the
session
Thank you for your cooperation!
2

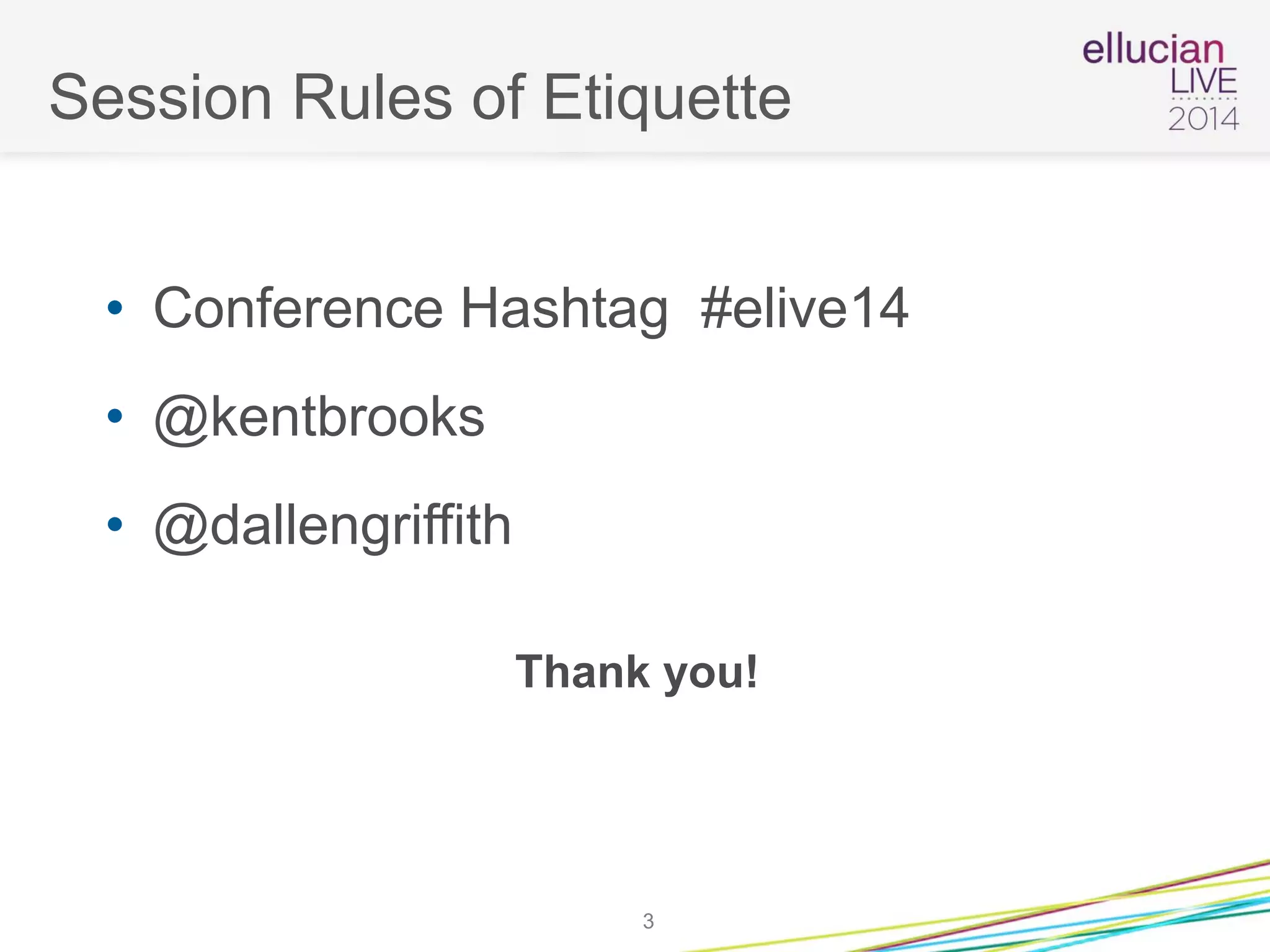

Session Rules of Etiquette
• Conference Hashtag #elive14
• @kentbrooks
• @dallengriffith
Thank you!
3
Agenda
• State of Wyoming Commission Project
Goals
• Wyoming Environment
• Project Time Line
• Project Phases
• Describe Solution
• Lessons Learned
4
Wyoming Community
Colleges and
Commission Goals

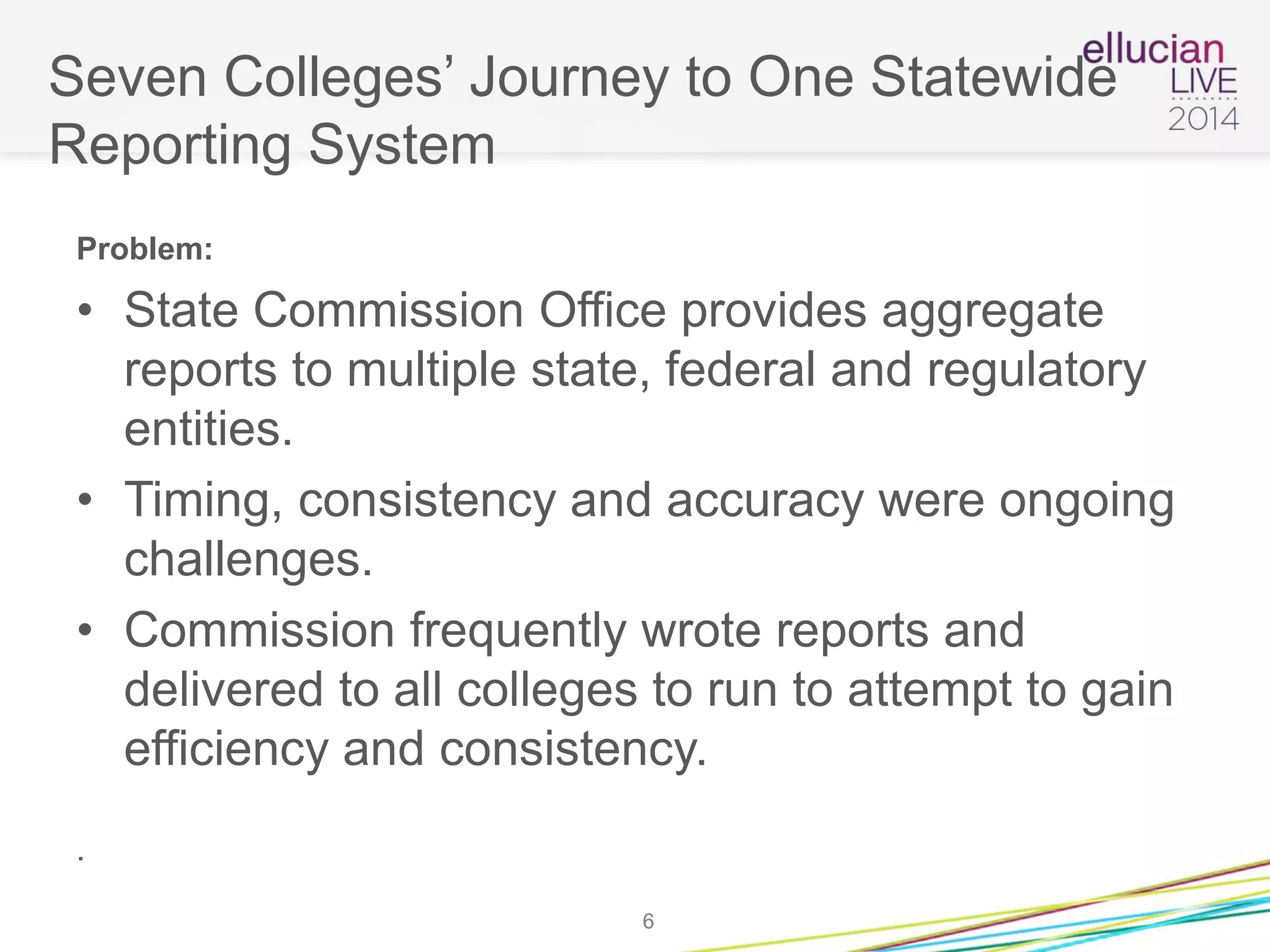

Seven Colleges’ Journey to One Statewide
Reporting System
Problem:
• State Commission Office provides aggregate
reports to multiple state, federal and regulatory
entities.
• Timing, consistency and accuracy were ongoing
challenges.
• Commission frequently wrote reports and
delivered to all colleges to run to attempt to gain
efficiency and consistency.
.
6

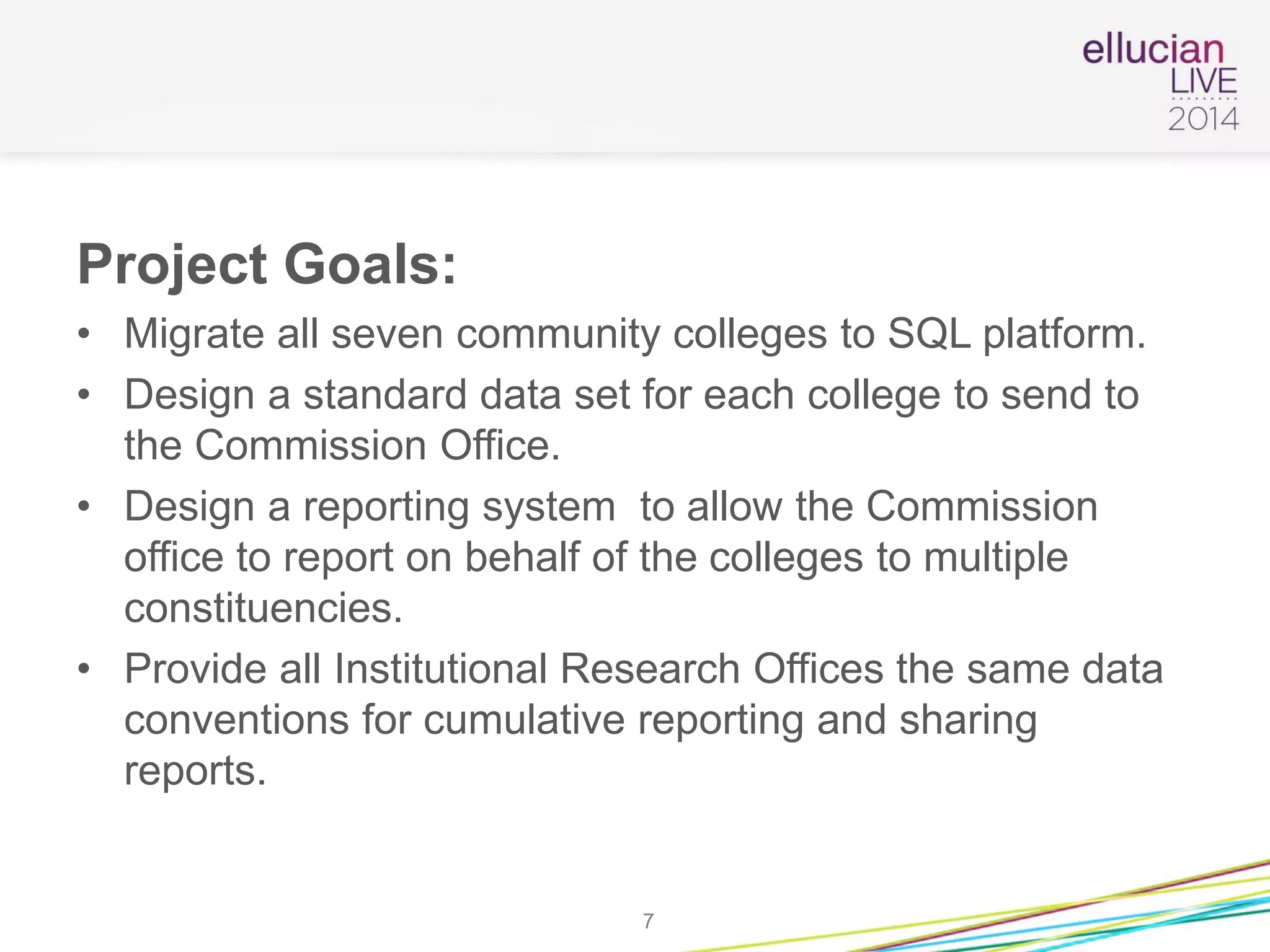

Project Goals:
• Migrate all seven community colleges to SQL platform.
• Design a standard data set for each college to send to
the Commission Office.
• Design a reporting system to allow the Commission
office to report on behalf of the colleges to multiple
constituencies.
• Provide all Institutional Research Offices the same data
conventions for cumulative reporting and sharing
reports.
7
Wyoming Community
College Commission
and Campus
Environment

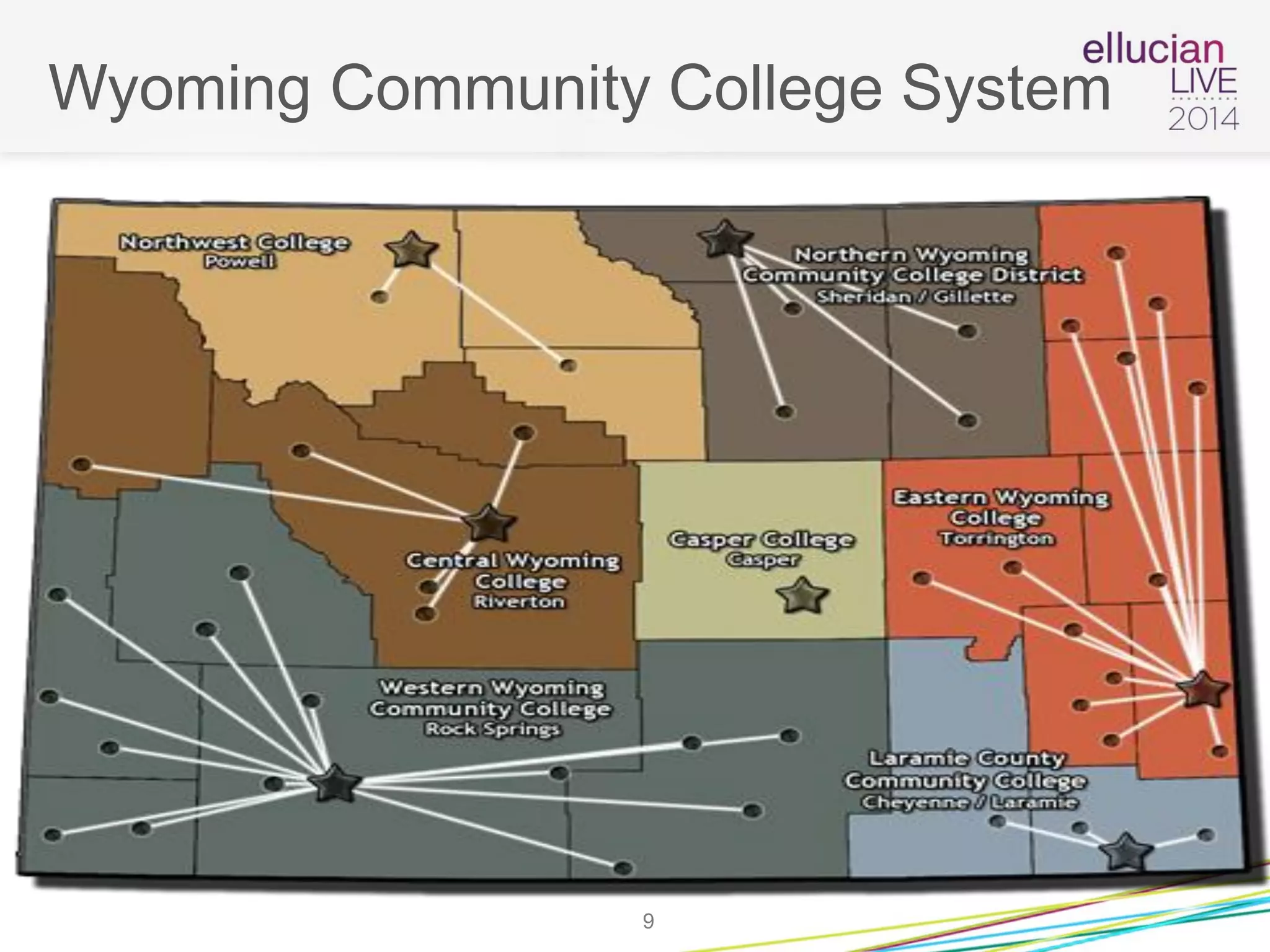

Wyoming Community College System
9

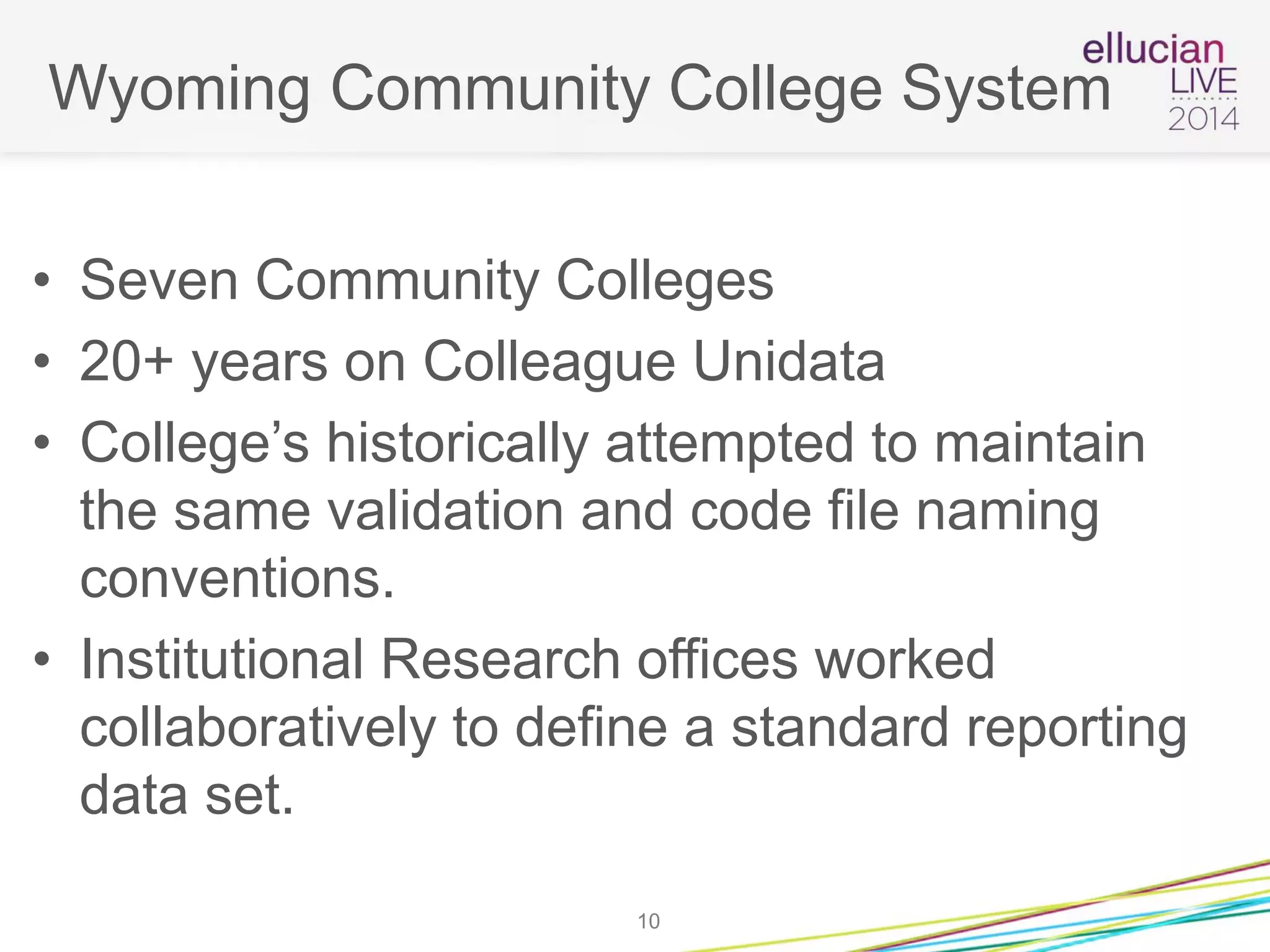

Wyoming Community College System
• Seven Community Colleges
• 20+ years on Colleague Unidata
• College’s historically attempted to maintain
the same validation and code file naming
conventions.
• Institutional Research offices worked
collaboratively to define a standard reporting
data set.
10
System Solution

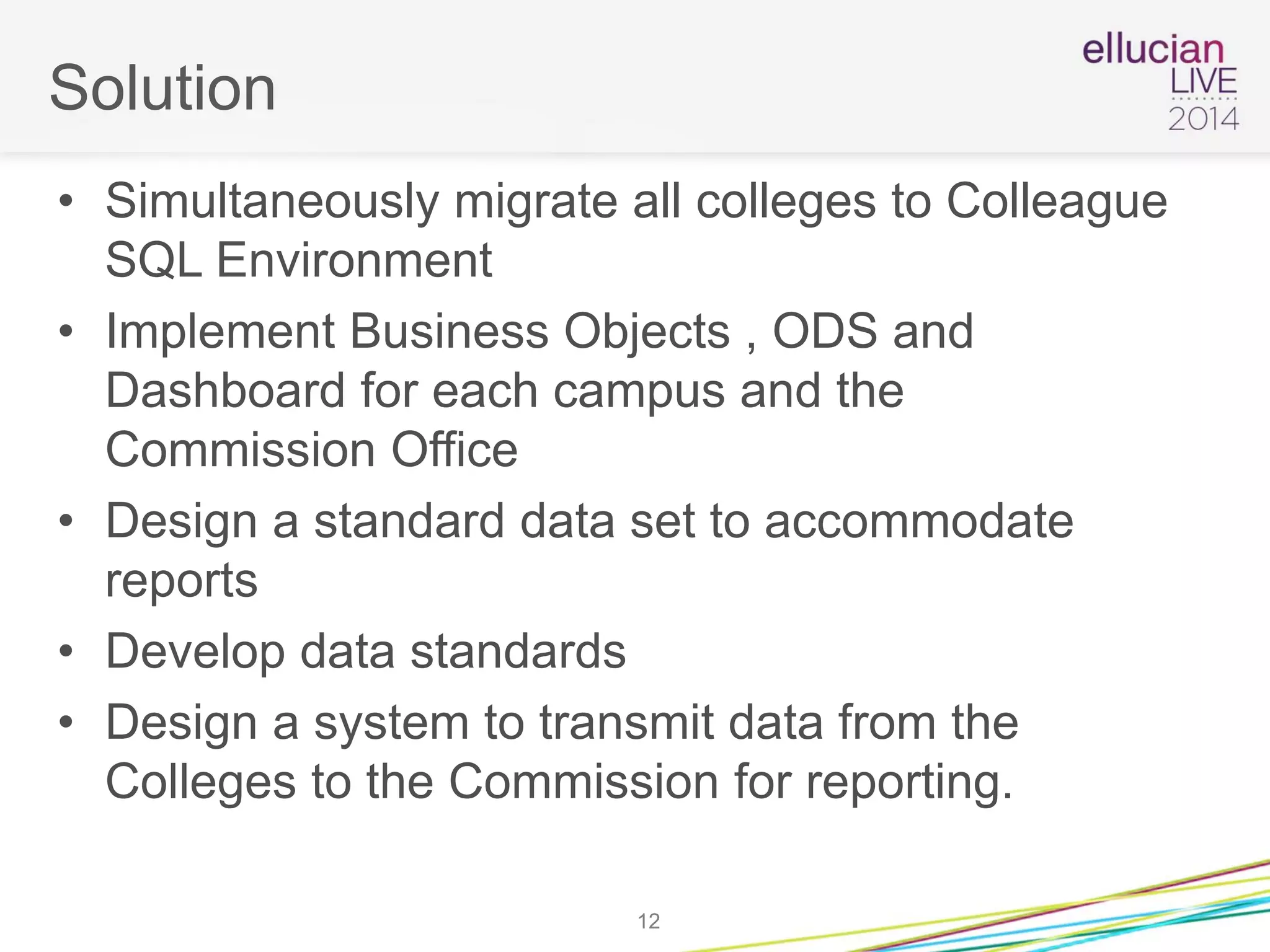

Solution
• Simultaneously migrate all colleges to Colleague
SQL Environment
• Implement Business Objects , ODS and
Dashboard for each campus and the
Commission Office
• Design a standard data set to accommodate
reports
• Develop data standards
• Design a system to transmit data from the
Colleges to the Commission for reporting.
12

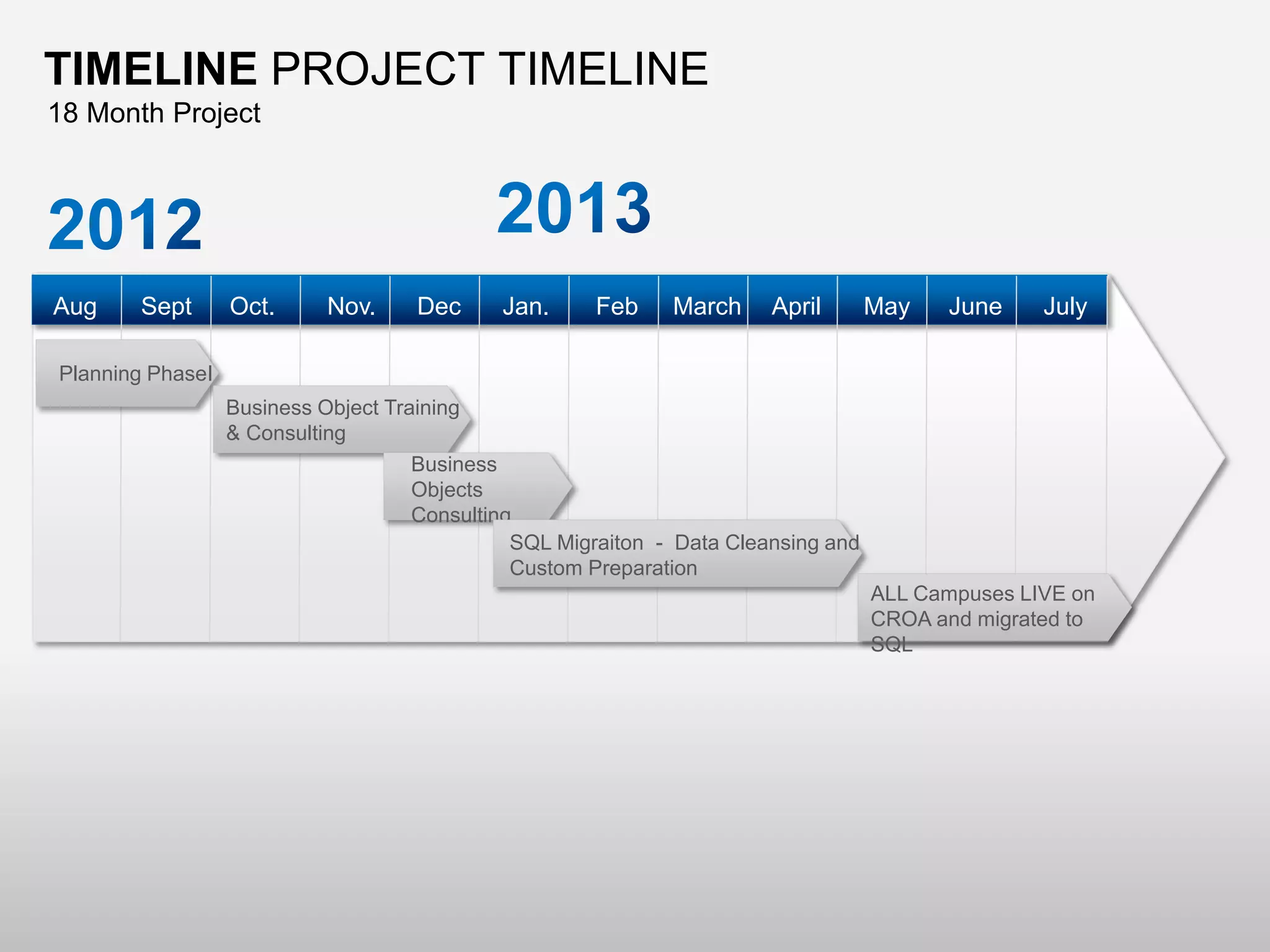

Solution Time Line
Planning PhaseI
Business Object Training
& Consulting
Business
Objects
Consulting
SQL Migraiton - Data Cleansing and
Custom Preparation
TIMELINE PROJECT TIMELINE
JulyMayAprilMarchFebJan.Nov.Oct.SeptAug Dec June
18 Month Project
ALL Campuses LIVE on
CROA and migrated to
SQL

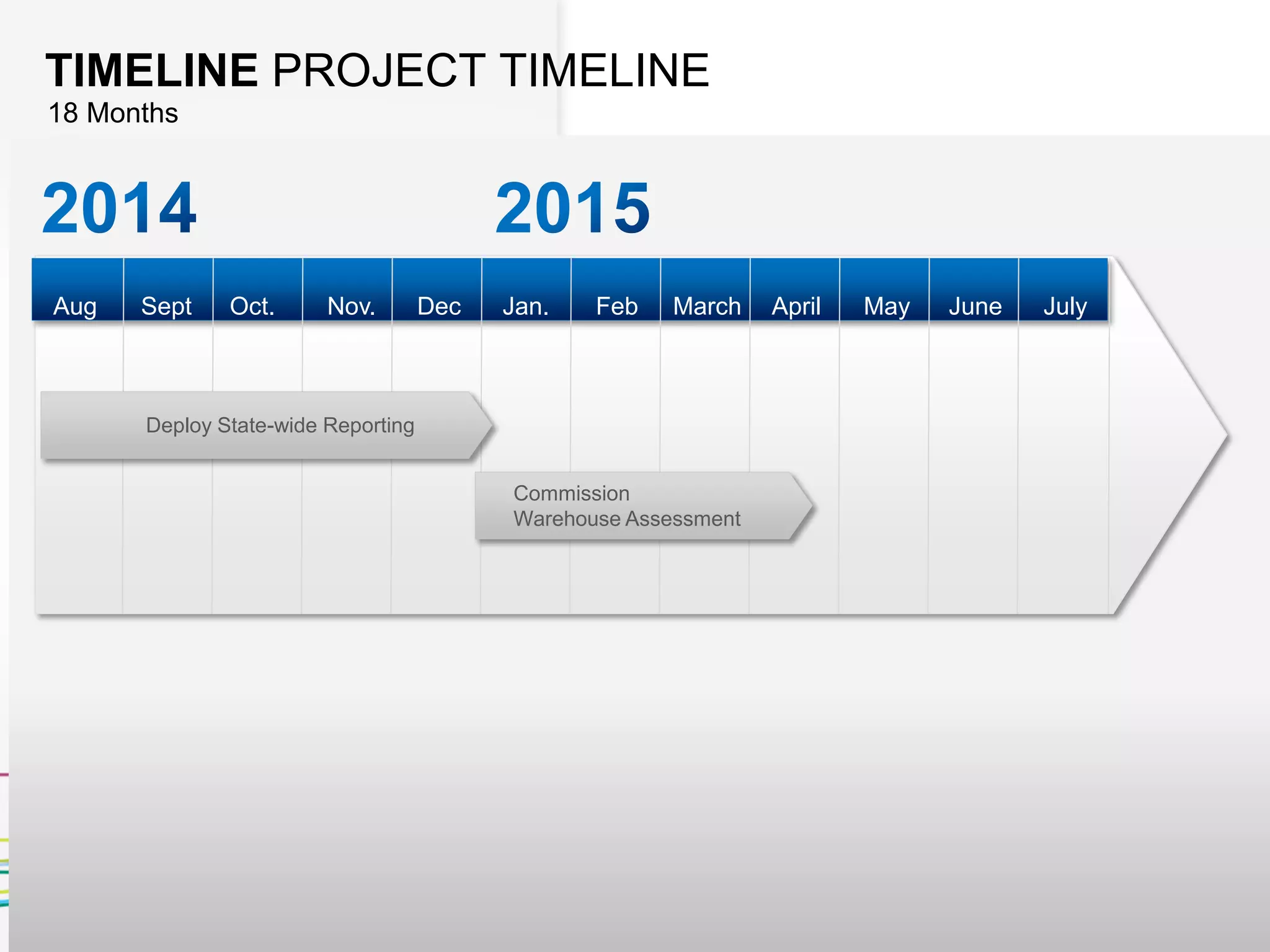

Deploy State-wide Reporting
Commission
Warehouse Assessment
TIMELINE PROJECT TIMELINE
JulyMayAprilMarchFebJan.Nov.Oct.SeptAug Dec June
18 Months
Solution Design

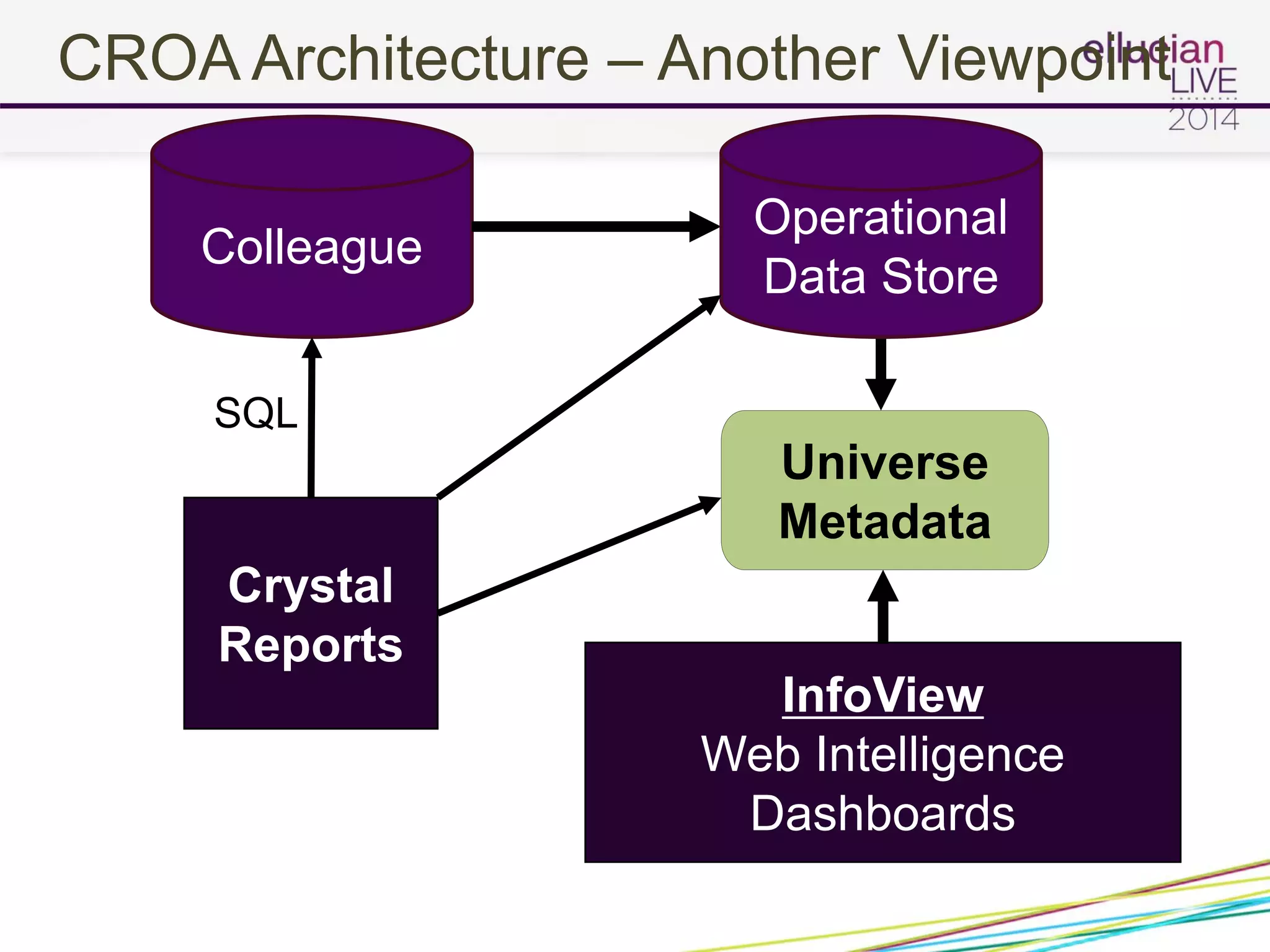

CROA Architecture – Another Viewpoint
Colleague
Universe
Metadata
Crystal
Reports
InfoView
Web Intelligence
Dashboards
Operational
Data Store
SQL

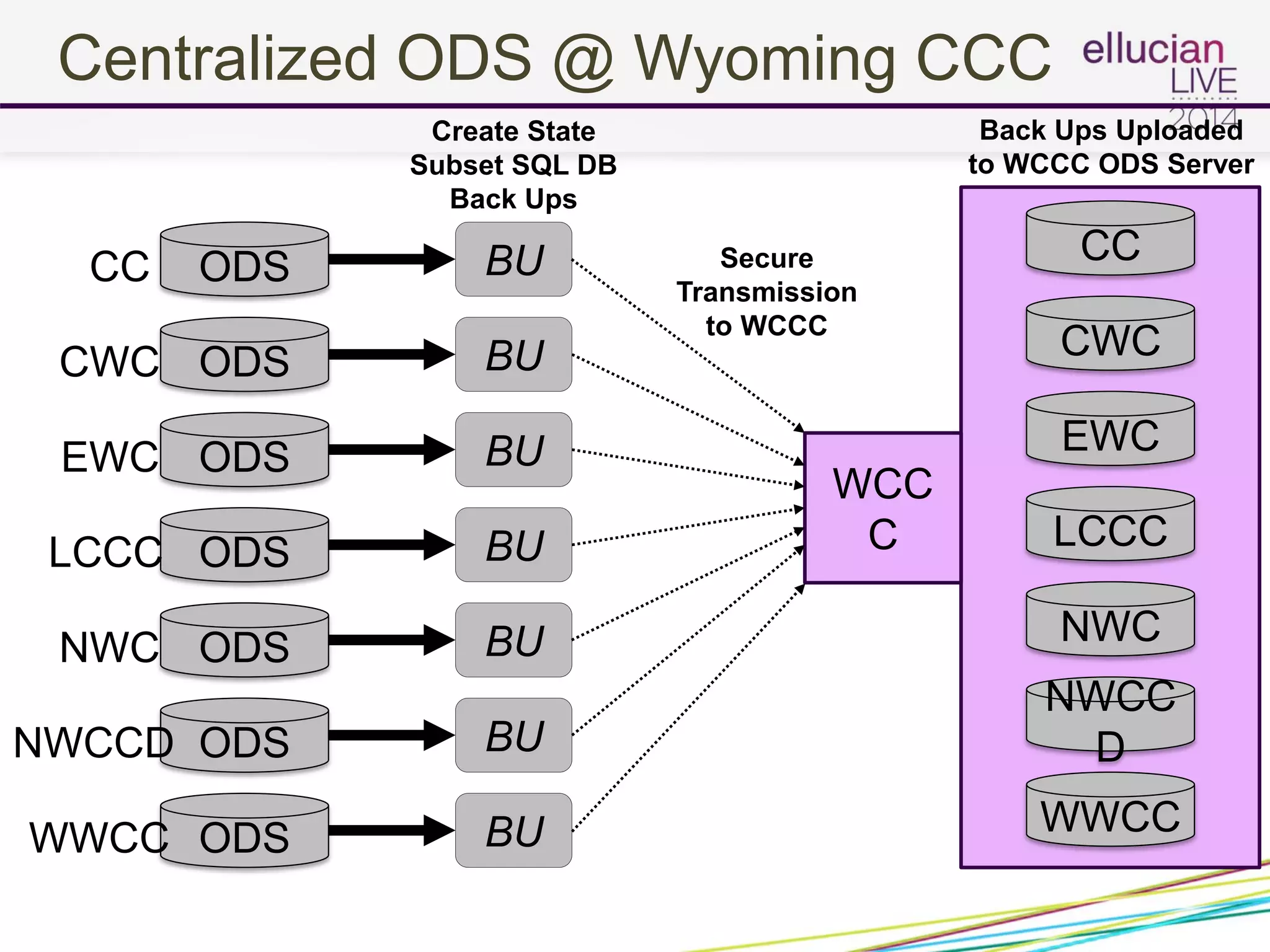

Centralized ODS @ Wyoming CCC
ODS
ODS
ODS
ODS
ODS
ODS
ODS
CC
CWC
EWC
LCCC
NWC
NWCCD
WWCC
BU
BU
BU
BU
BU
BU
BU
Create State
Subset SQL DB
Back Ups
CC
CWC
EWC
LCCC
NWC
NWCC
D
WWCC
Back Ups Uploaded
to WCCC ODS Server
WCC
C
Secure
Transmission
to WCCC

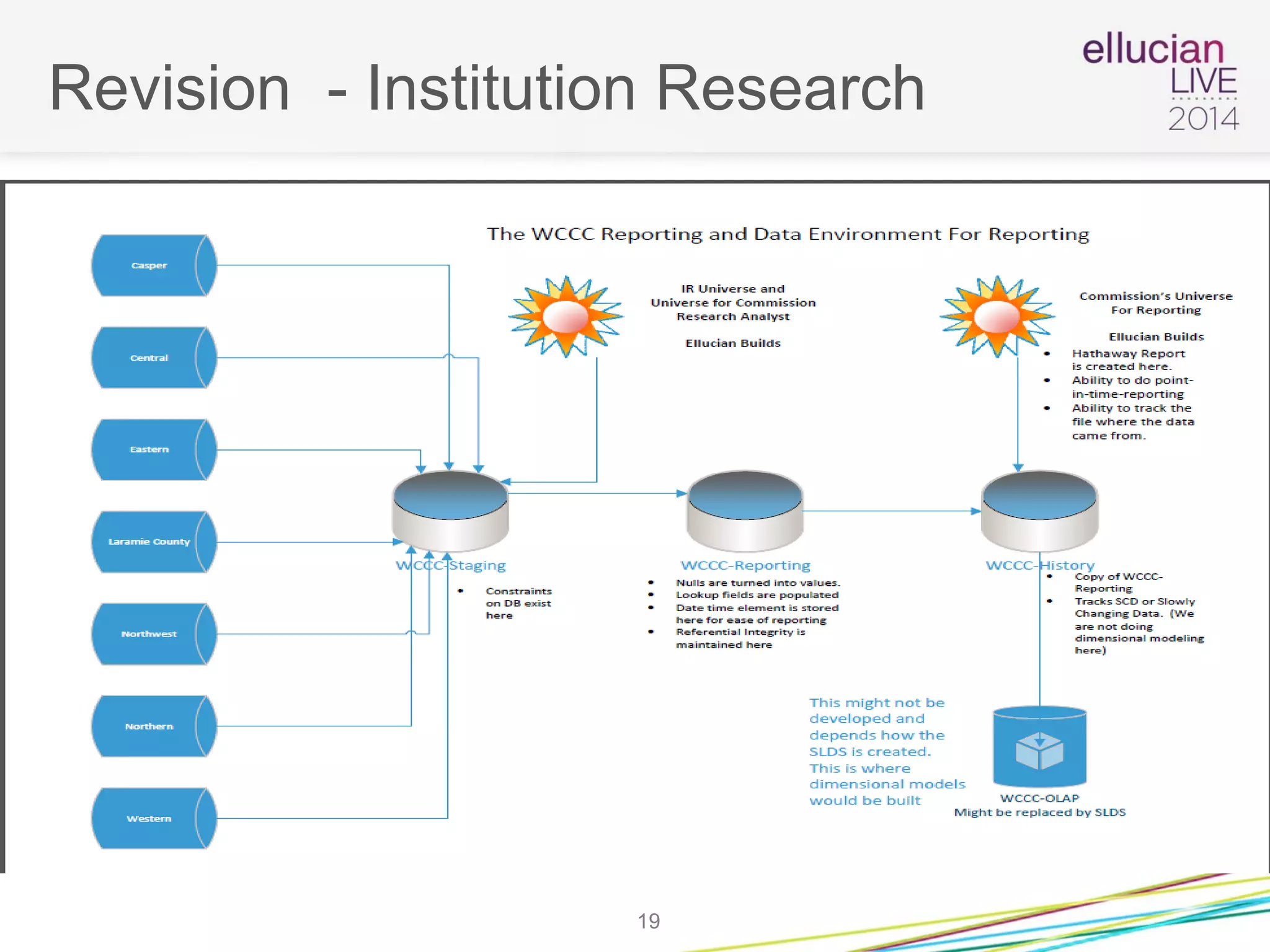

Revision - Institution Research
19

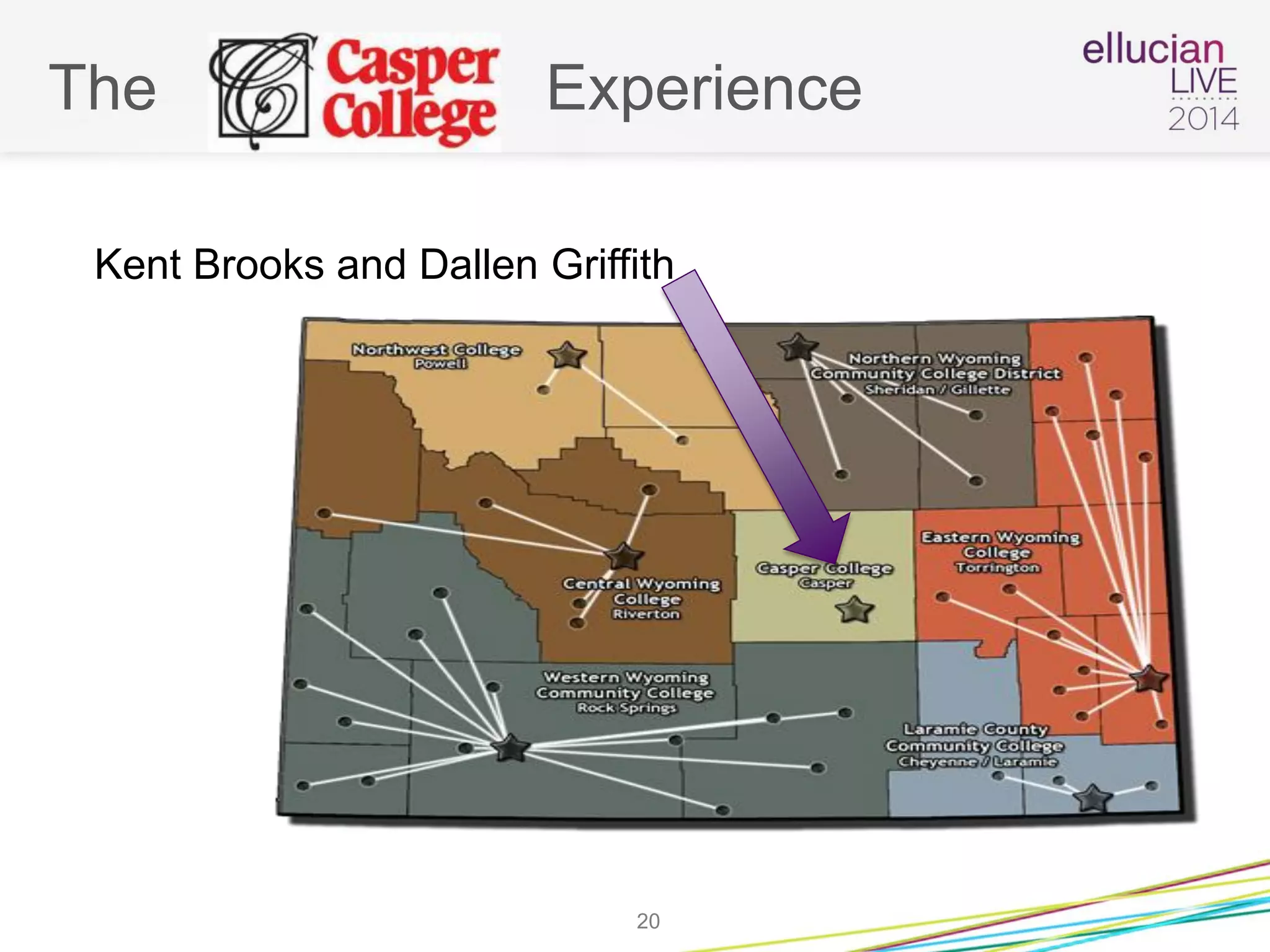

The Experience
20
Kent Brooks and Dallen Griffith
The Experience

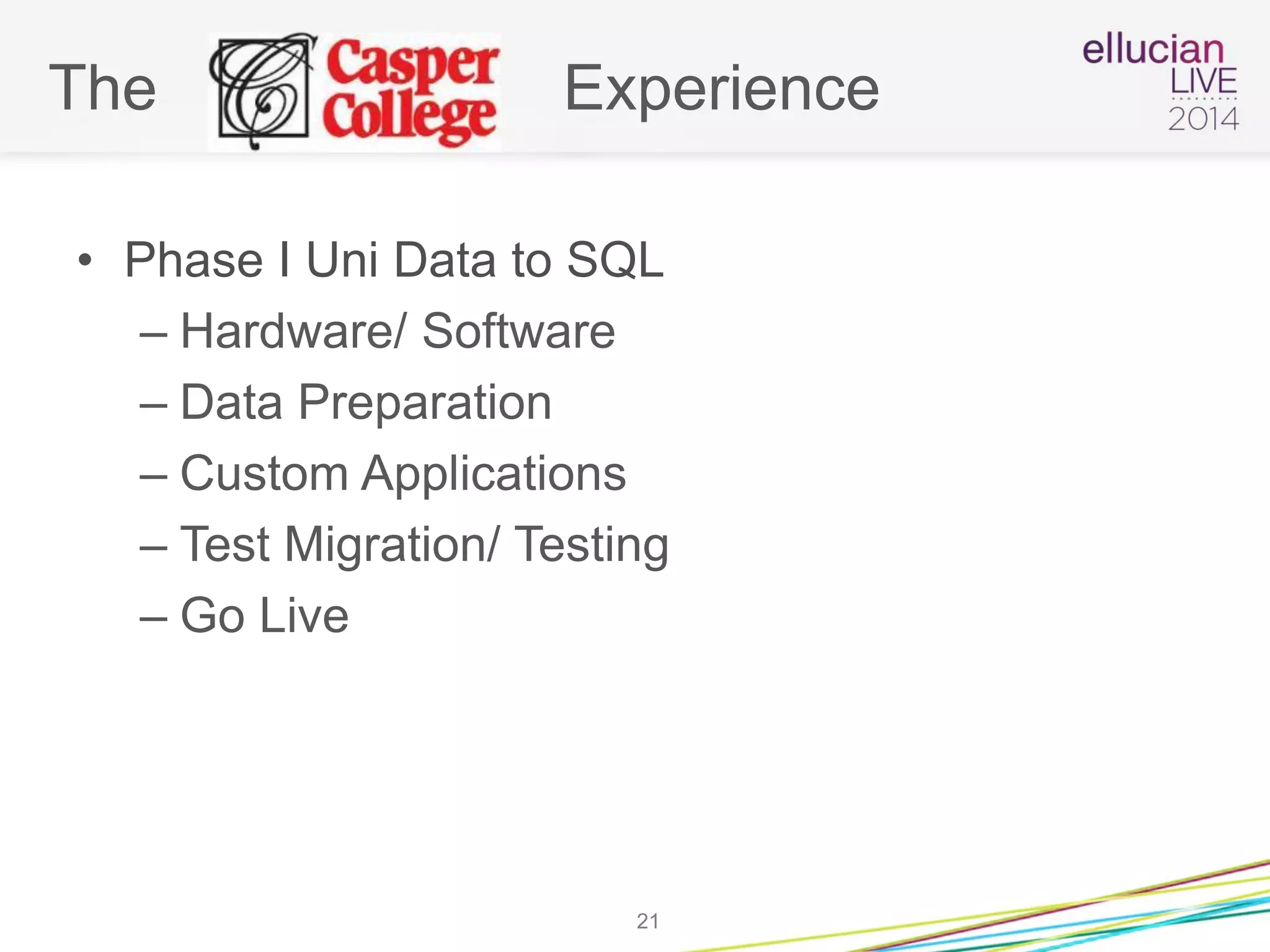

• Phase I Uni Data to SQL
– Hardware/ Software
– Data Preparation
– Custom Applications
– Test Migration/ Testing
– Go Live
21
The Experience
• Hardware/Software
– Hp 3000 Chassis
– We installed basics
• OS
• SQL
– Ellucian Installed and Setup Colleague
22

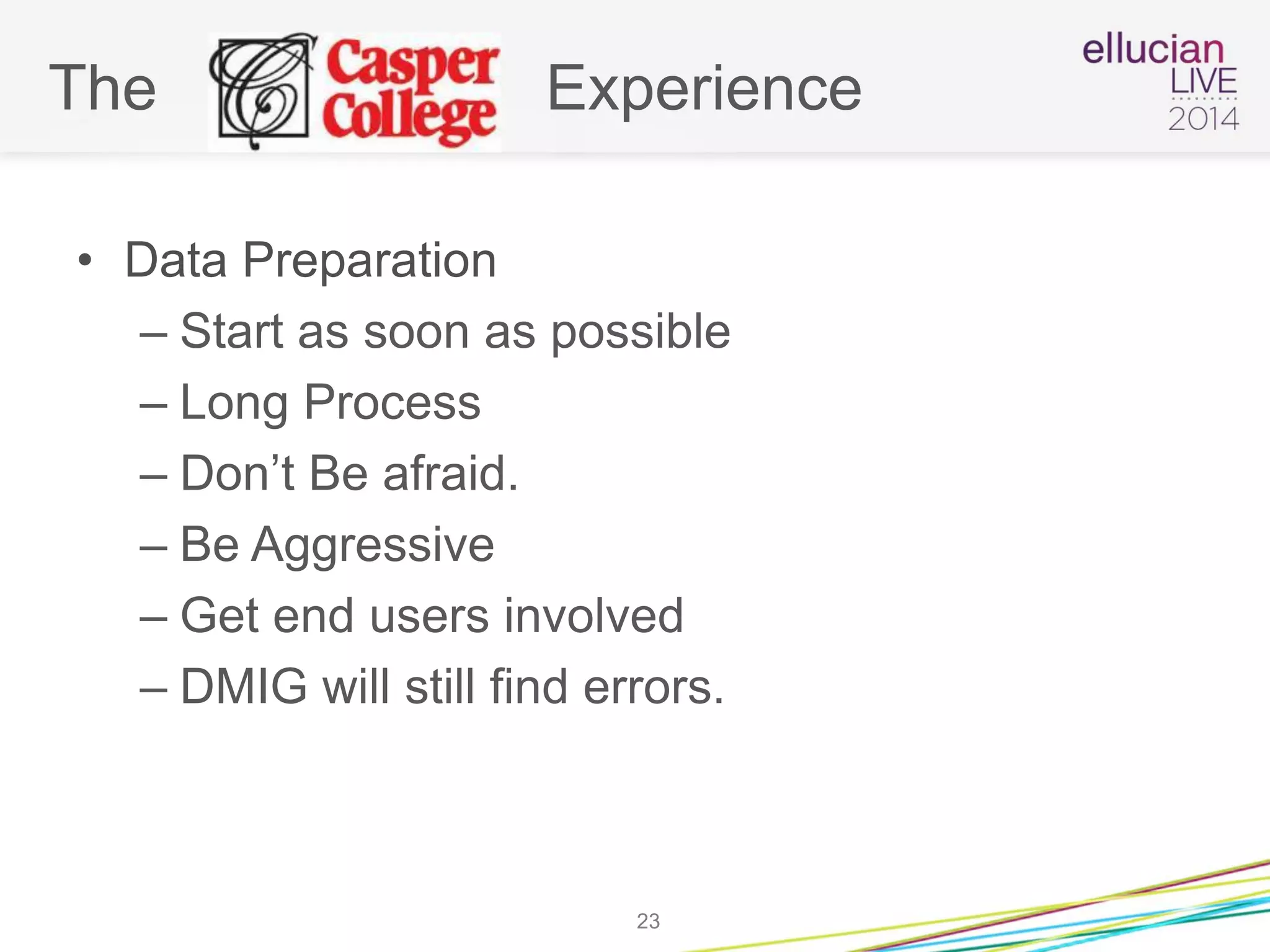

The Experience
• Data Preparation
– Start as soon as possible
– Long Process
– Don’t Be afraid.
– Be Aggressive
– Get end users involved
– DMIG will still find errors.
23
The Experience

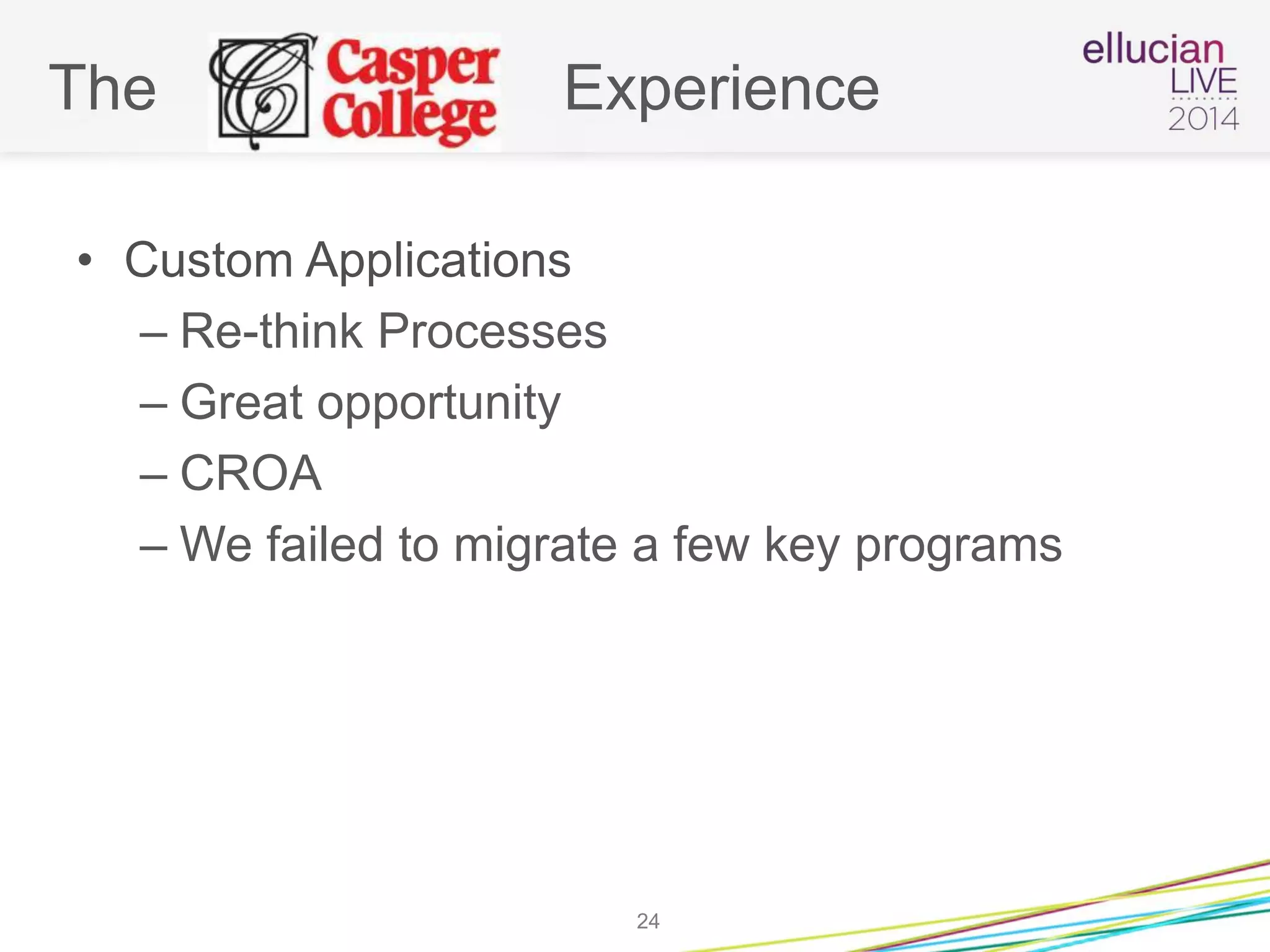

• Custom Applications
– Re-think Processes
– Great opportunity
– CROA
– We failed to migrate a few key programs
24
The Experience

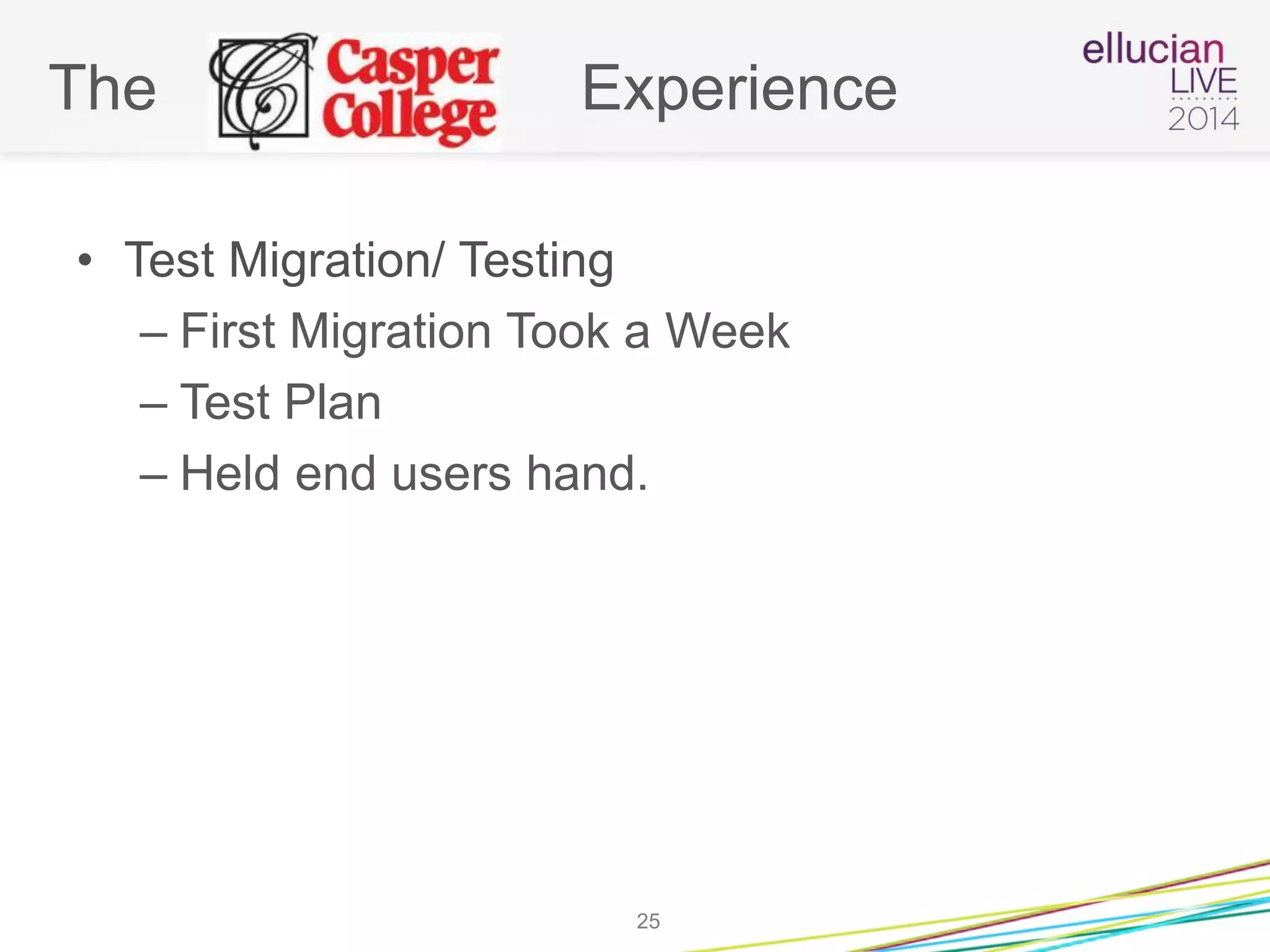

• Test Migration/ Testing
– First Migration Took a Week
– Test Plan
– Held end users hand.
25
The Experience

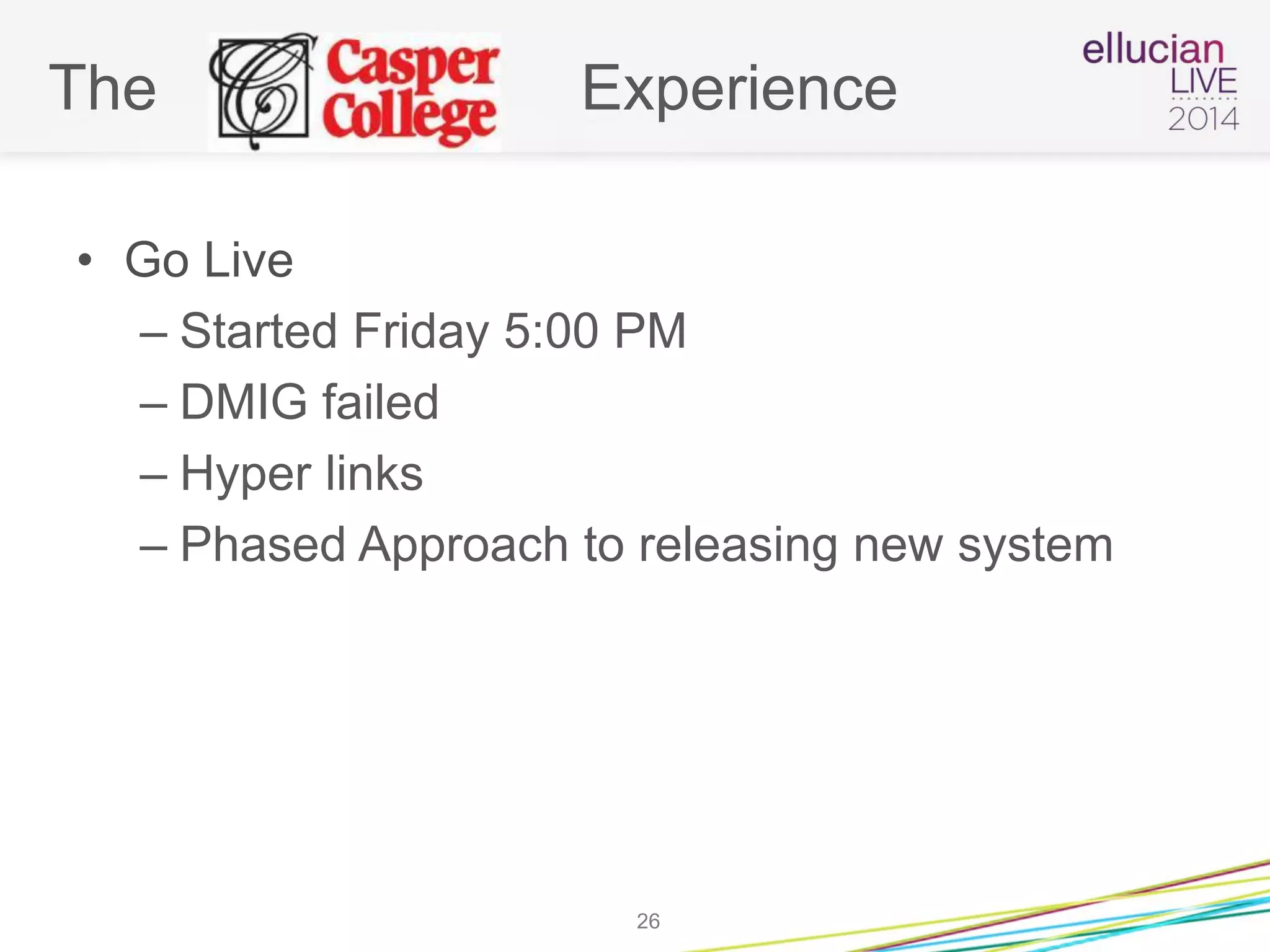

• Go Live
– Started Friday 5:00 PM
– DMIG failed
– Hyper links
– Phased Approach to releasing new system
26
The Experience

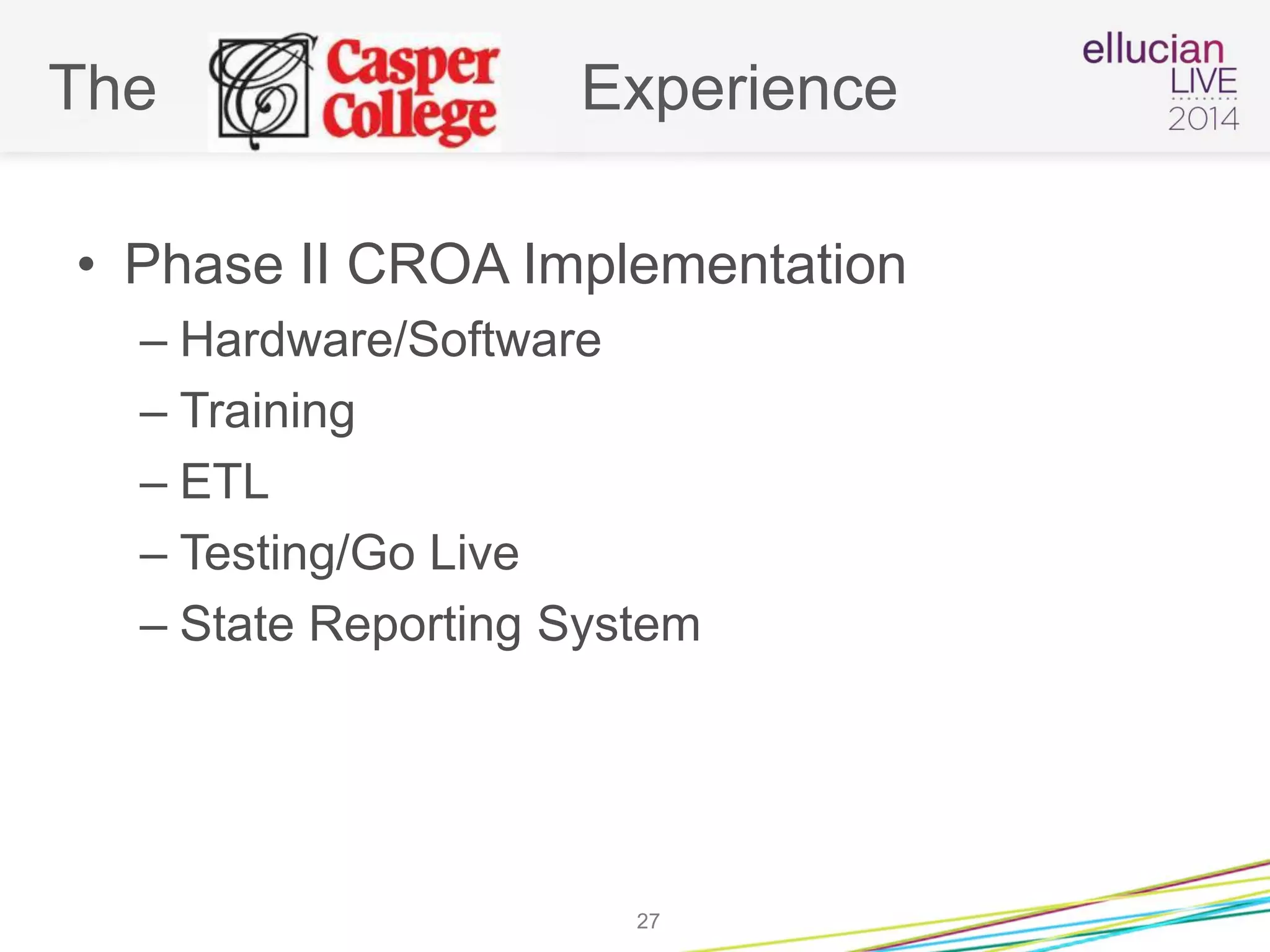

• Phase II CROA Implementation
– Hardware/Software
– Training
– ETL
– Testing/Go Live
– State Reporting System
27

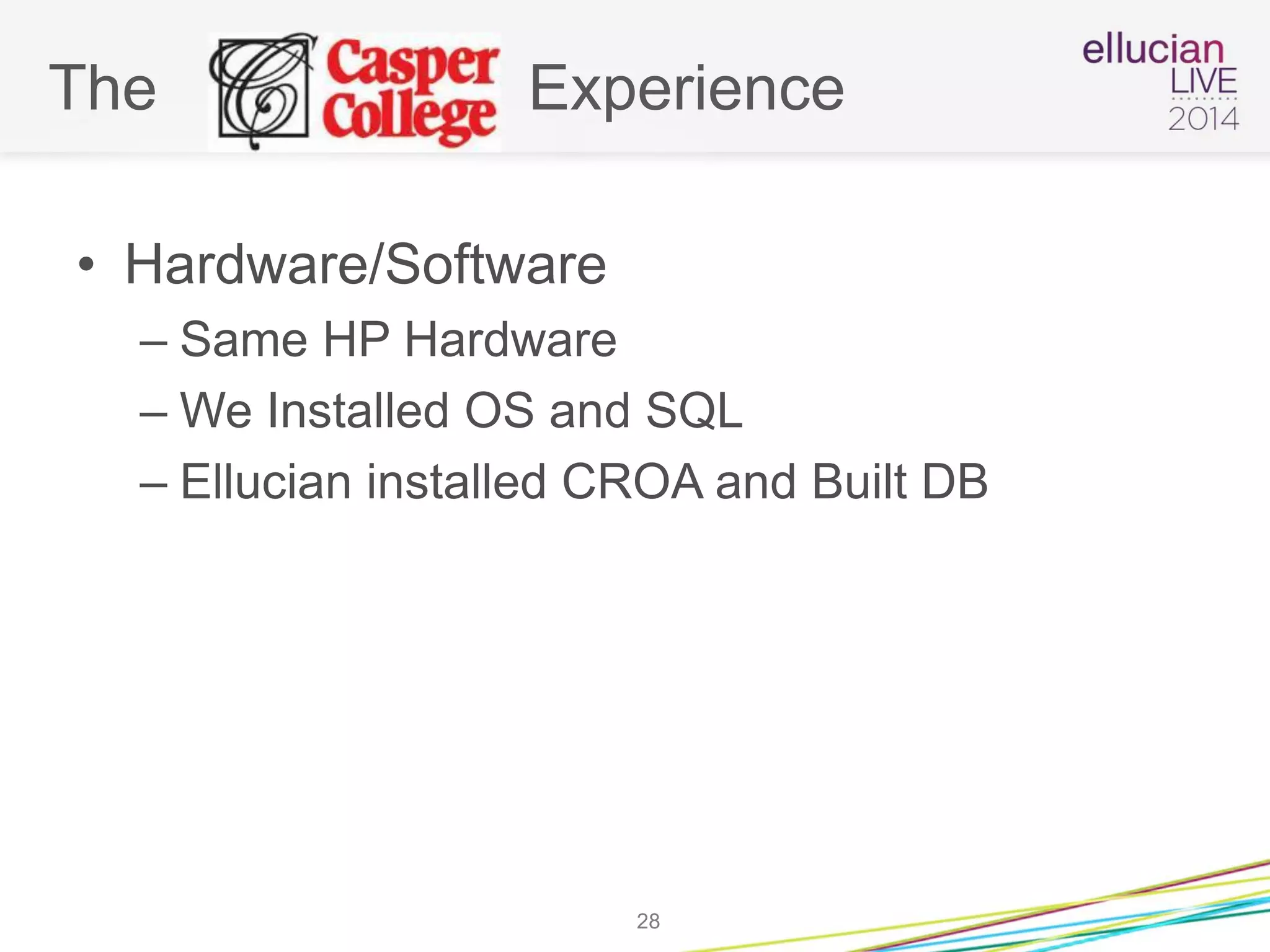

The Experience
• Hardware/Software
– Same HP Hardware
– We Installed OS and SQL
– Ellucian installed CROA and Built DB
28
The Experience

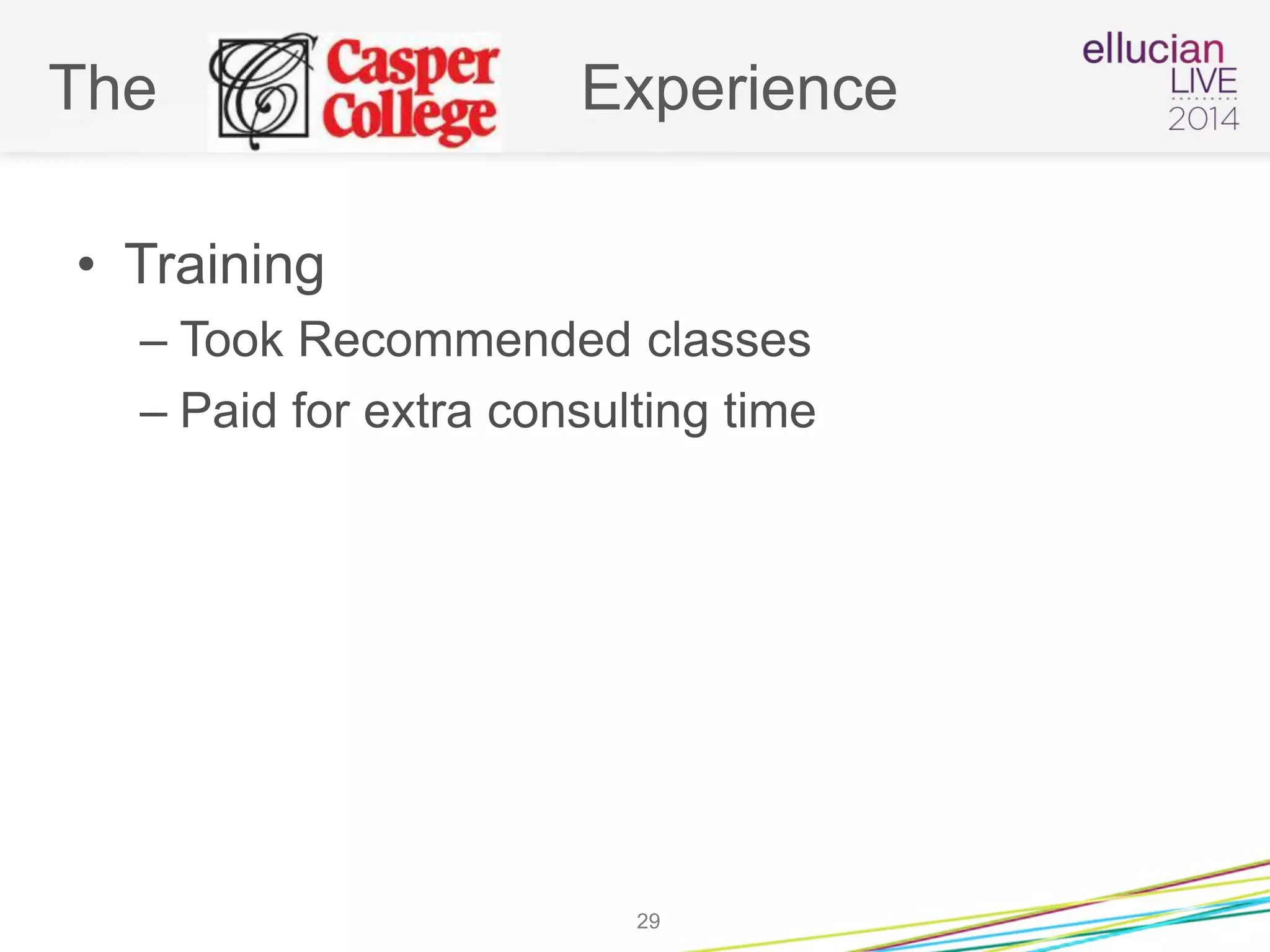

• Training
– Took Recommended classes
– Paid for extra consulting time
29
The Experience

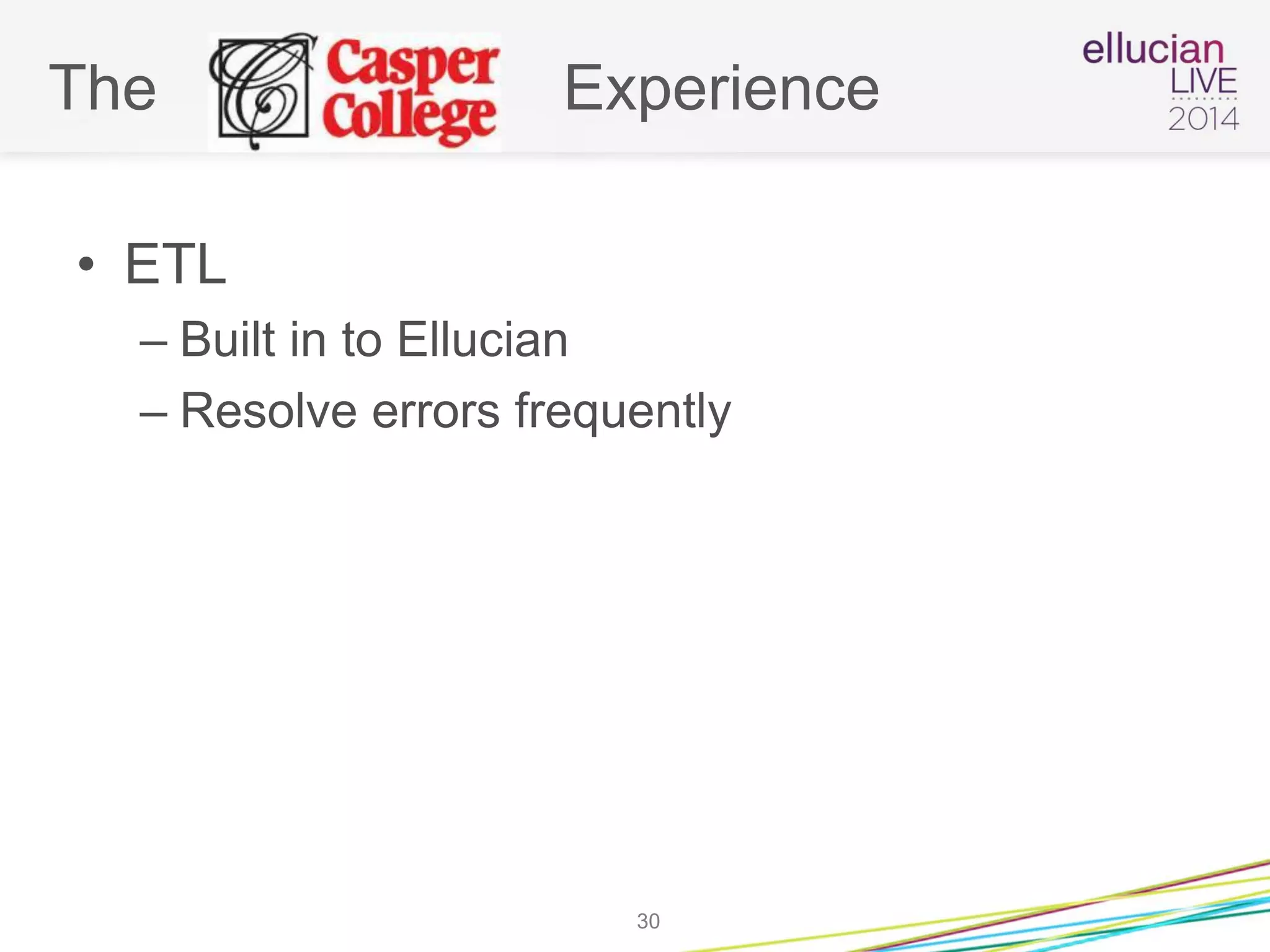

• ETL
– Built in to Ellucian
– Resolve errors frequently
30
The Experience

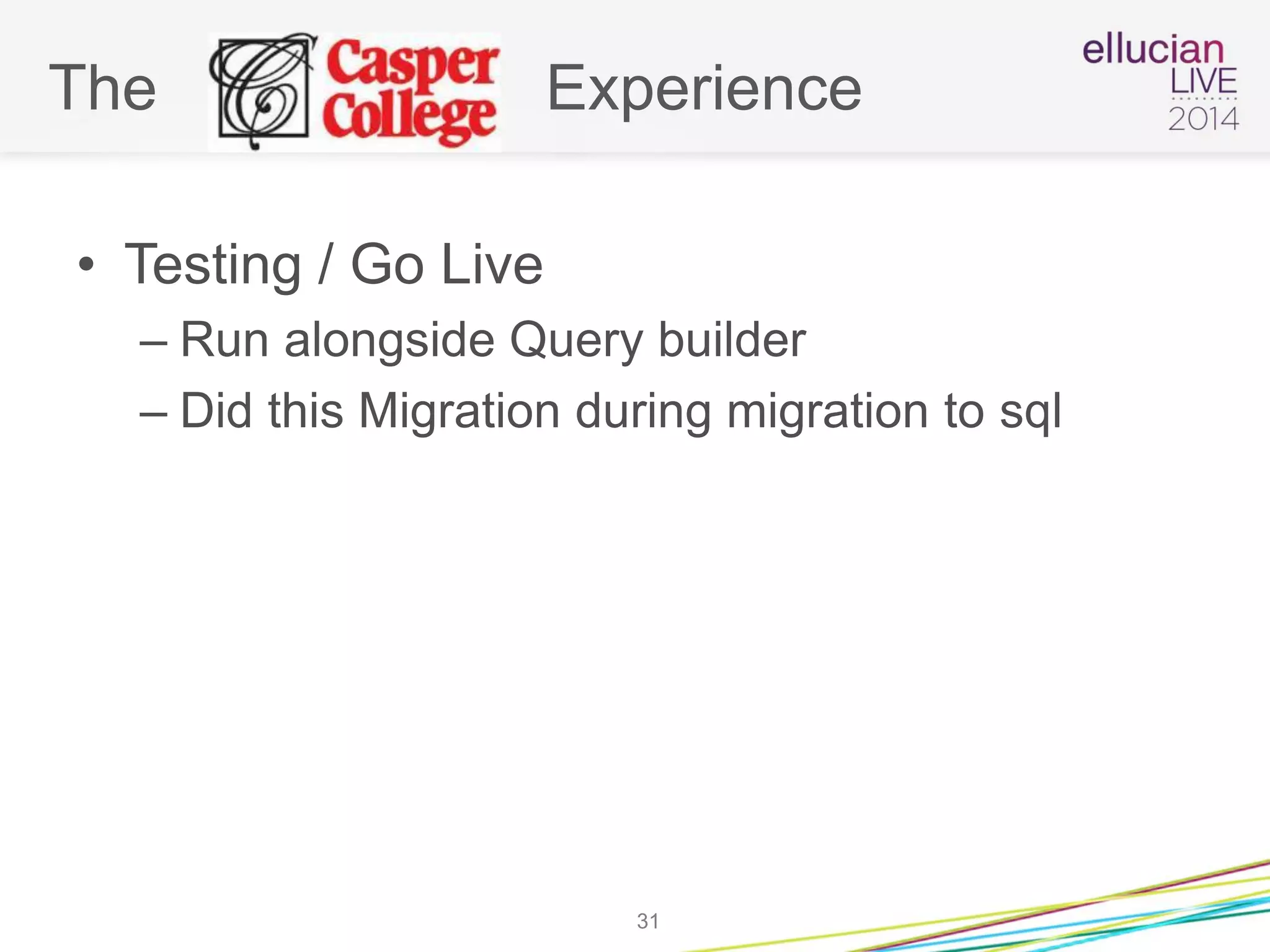

• Testing / Go Live
– Run alongside Query builder
– Did this Migration during migration to sql
31

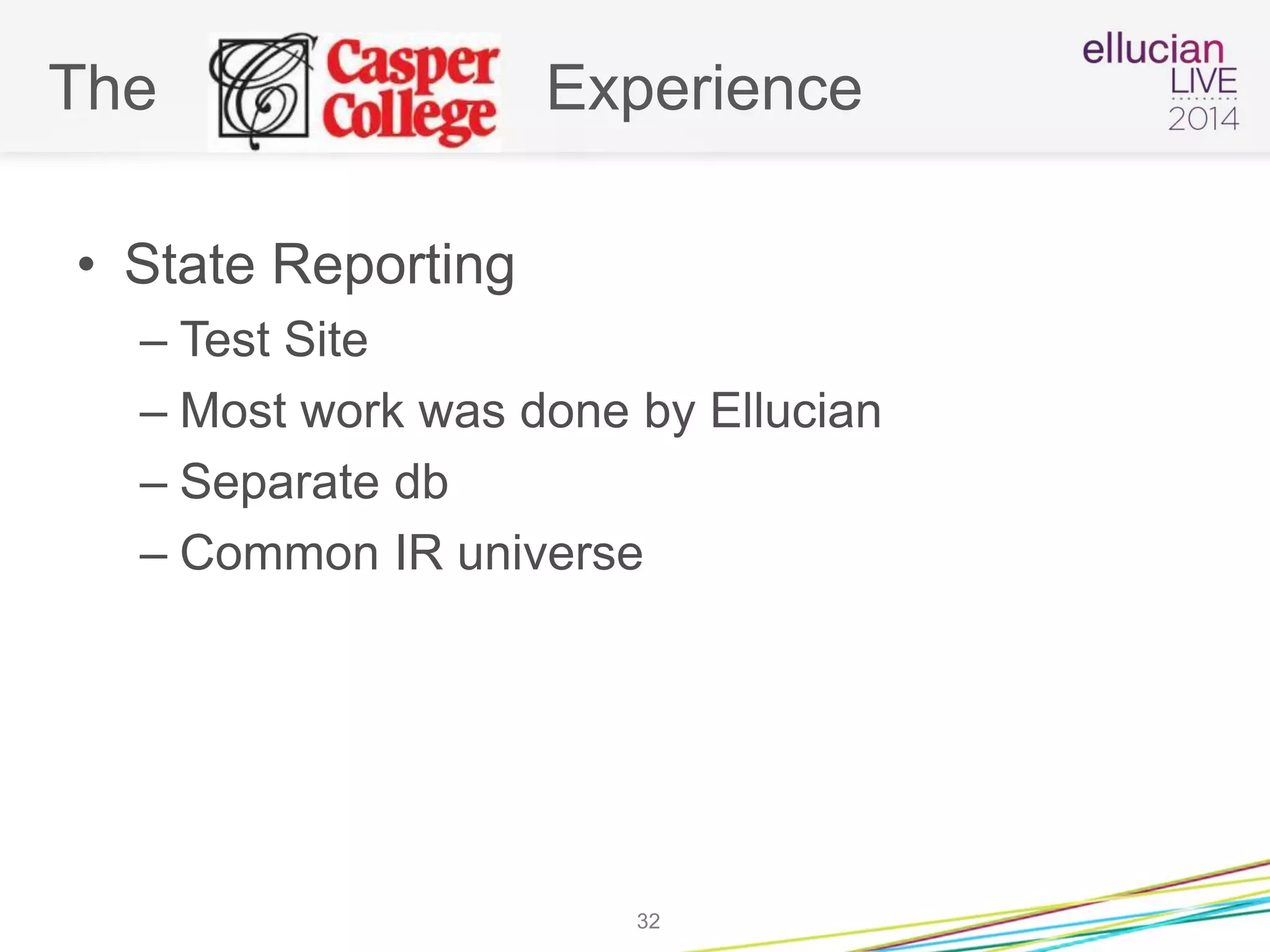

The Experience
• State Reporting
– Test Site
– Most work was done by Ellucian
– Separate db
– Common IR universe
32
The Experience
• Phase III
– Beyond CROA to Business Intelligence
33
The Experience
“We don’t have enough data….the
sample size is too small”
-Moneyball
34
The Experience

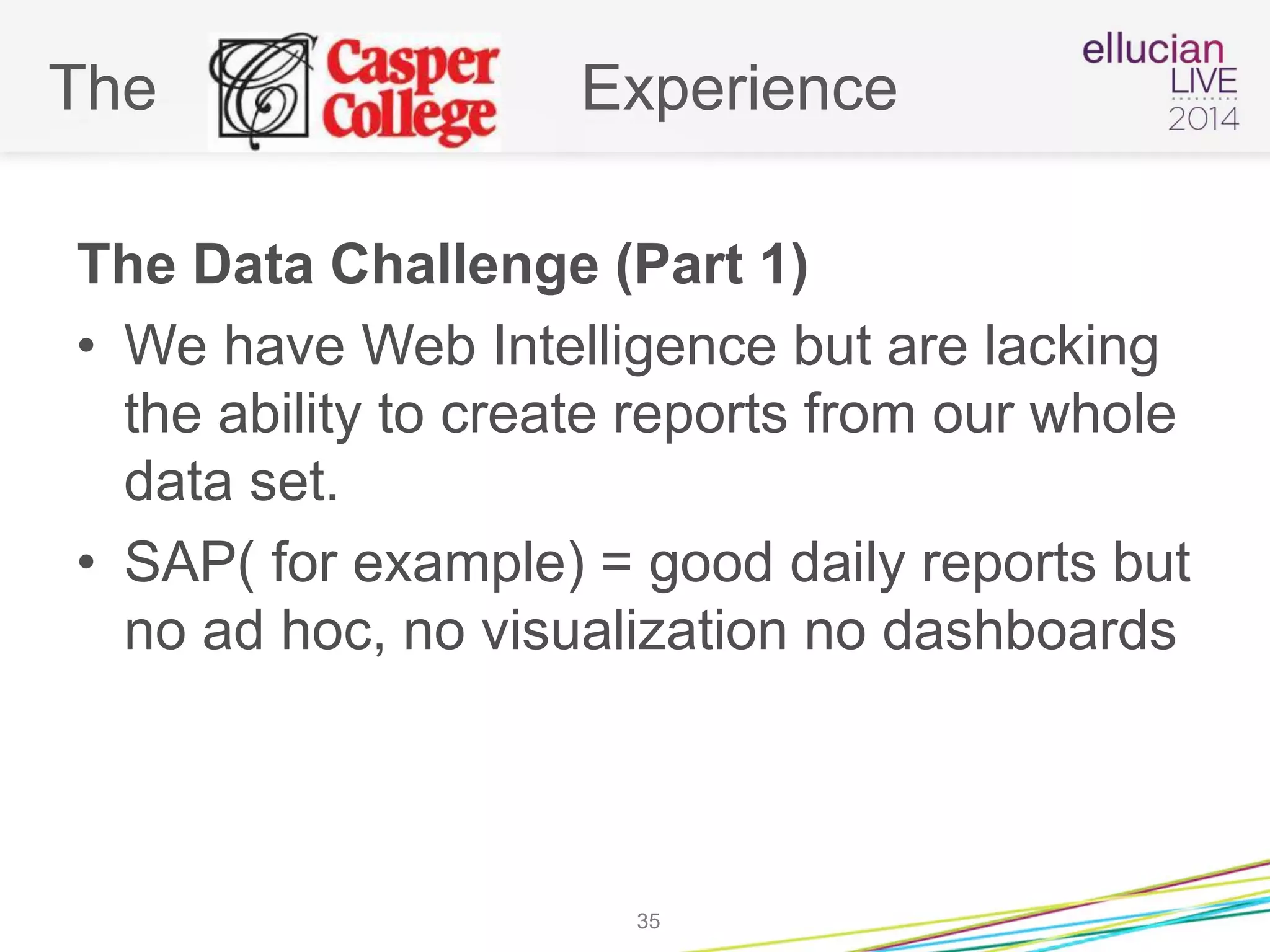

The Data Challenge (Part 1)
• We have Web Intelligence but are lacking
the ability to create reports from our whole
data set.
• SAP( for example) = good daily reports but
no ad hoc, no visualization no dashboards
35
The Experience

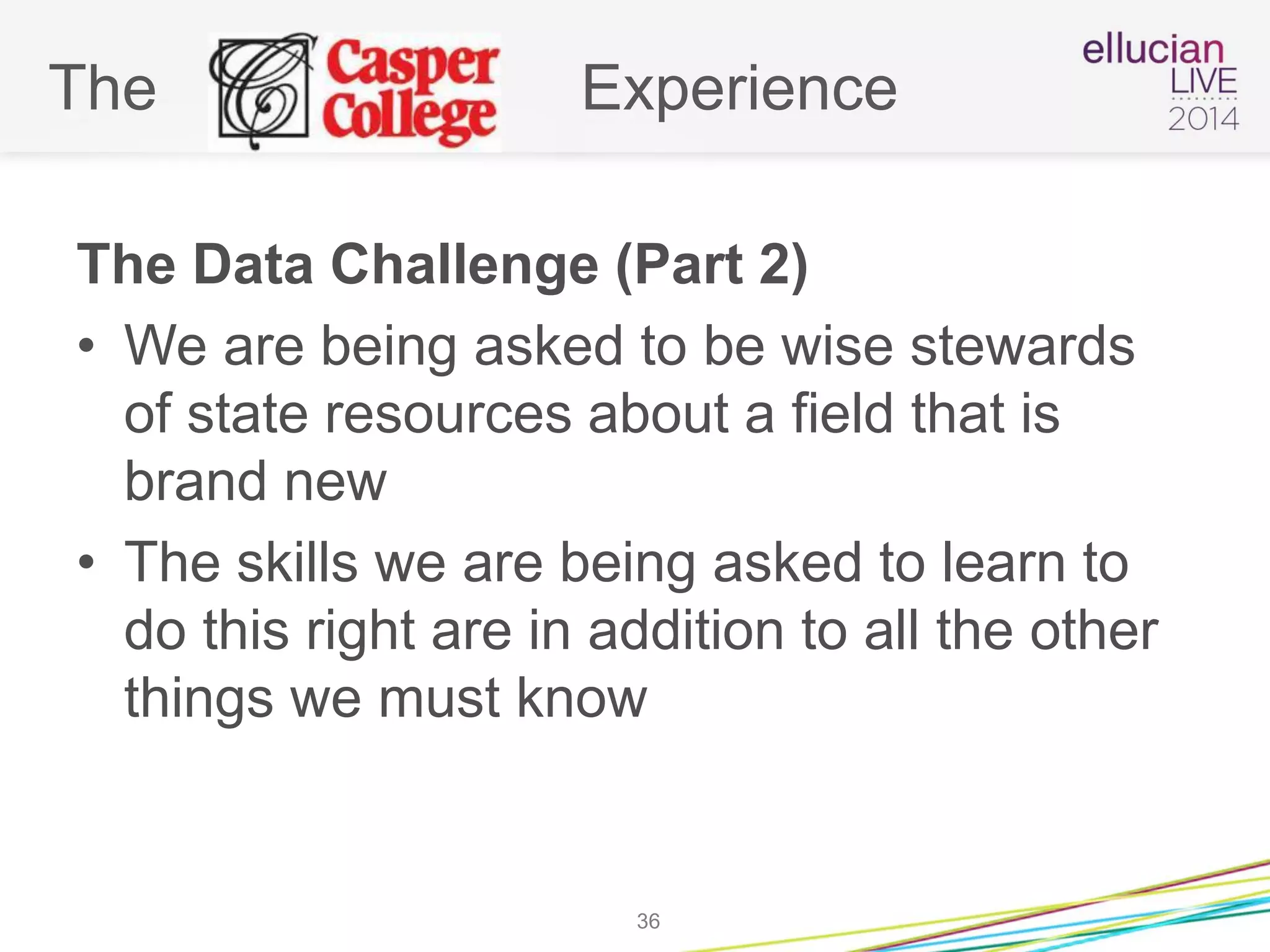

The Data Challenge (Part 2)
• We are being asked to be wise stewards
of state resources about a field that is
brand new
• The skills we are being asked to learn to
do this right are in addition to all the other
things we must know
36
The Experience
Overcoming the Data Challenge

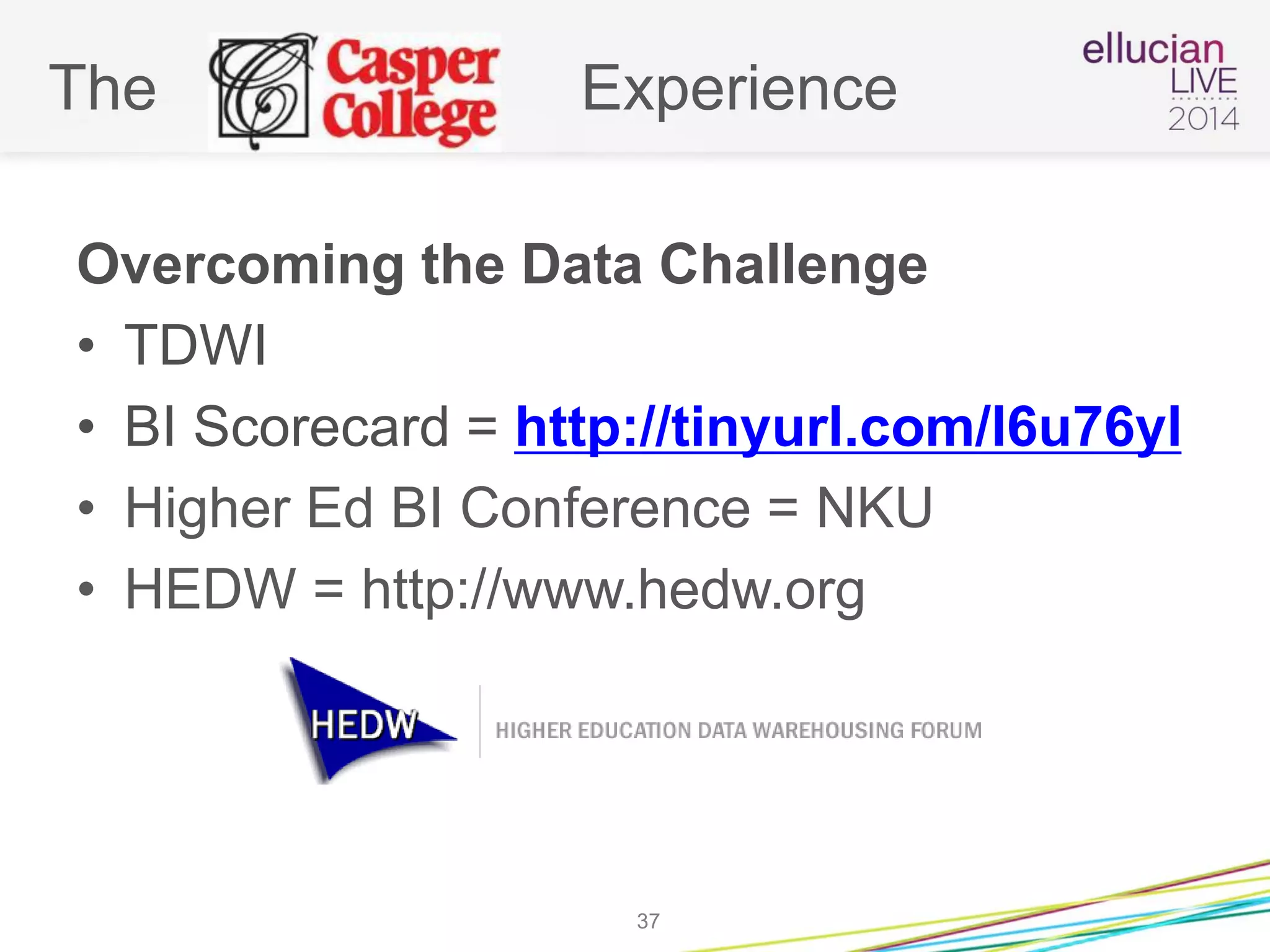

• TDWI
• BI Scorecard = http://tinyurl.com/l6u76yl
• Higher Ed BI Conference = NKU
• HEDW = http://www.hedw.org
37
The Experience

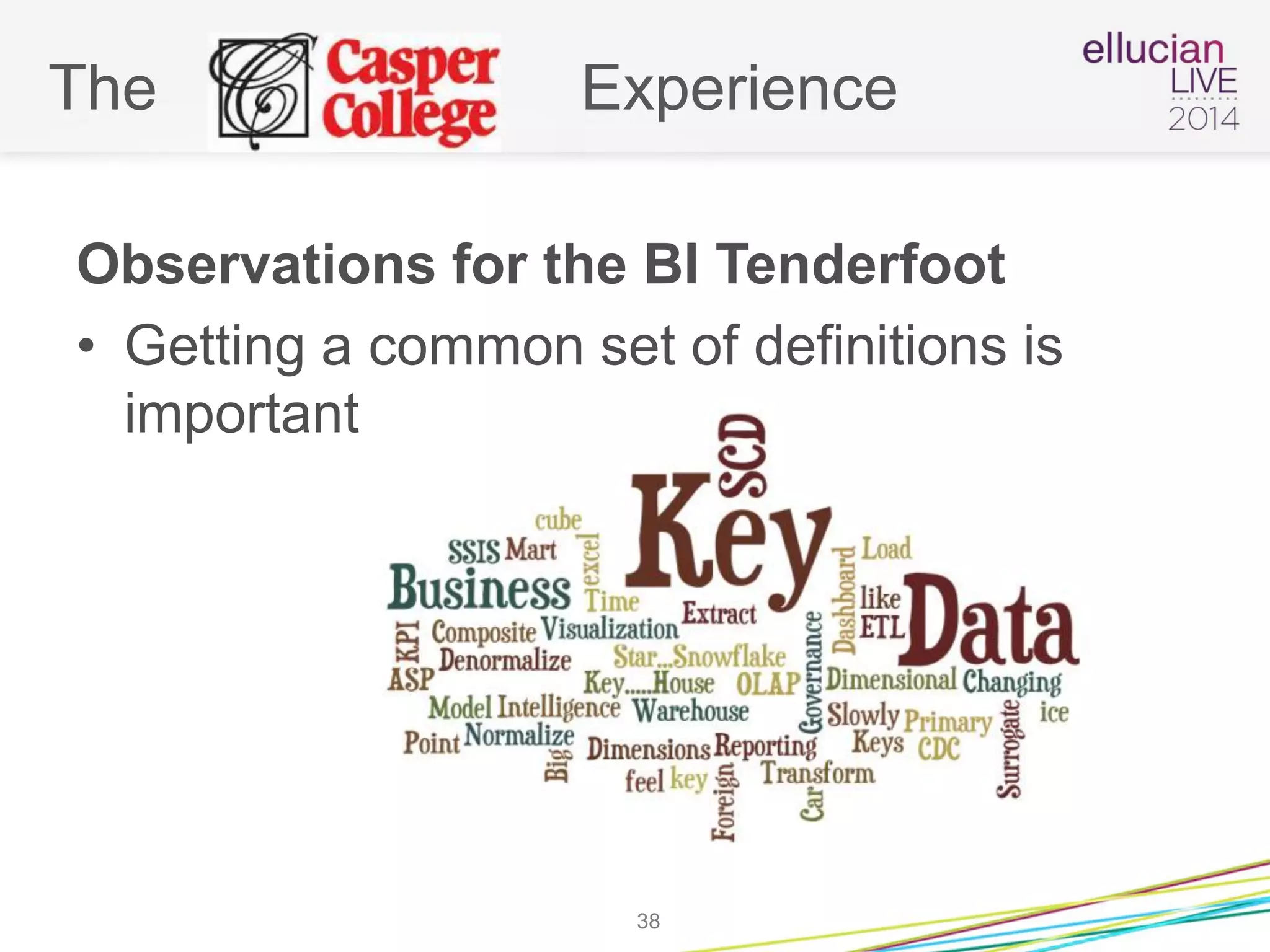

Observations for the BI Tenderfoot
• Getting a common set of definitions is
important
38
The Experience
Observations for the BI Tenderfoot
• We are decent at collecting data but not at
turning data into useful and timely
information
39

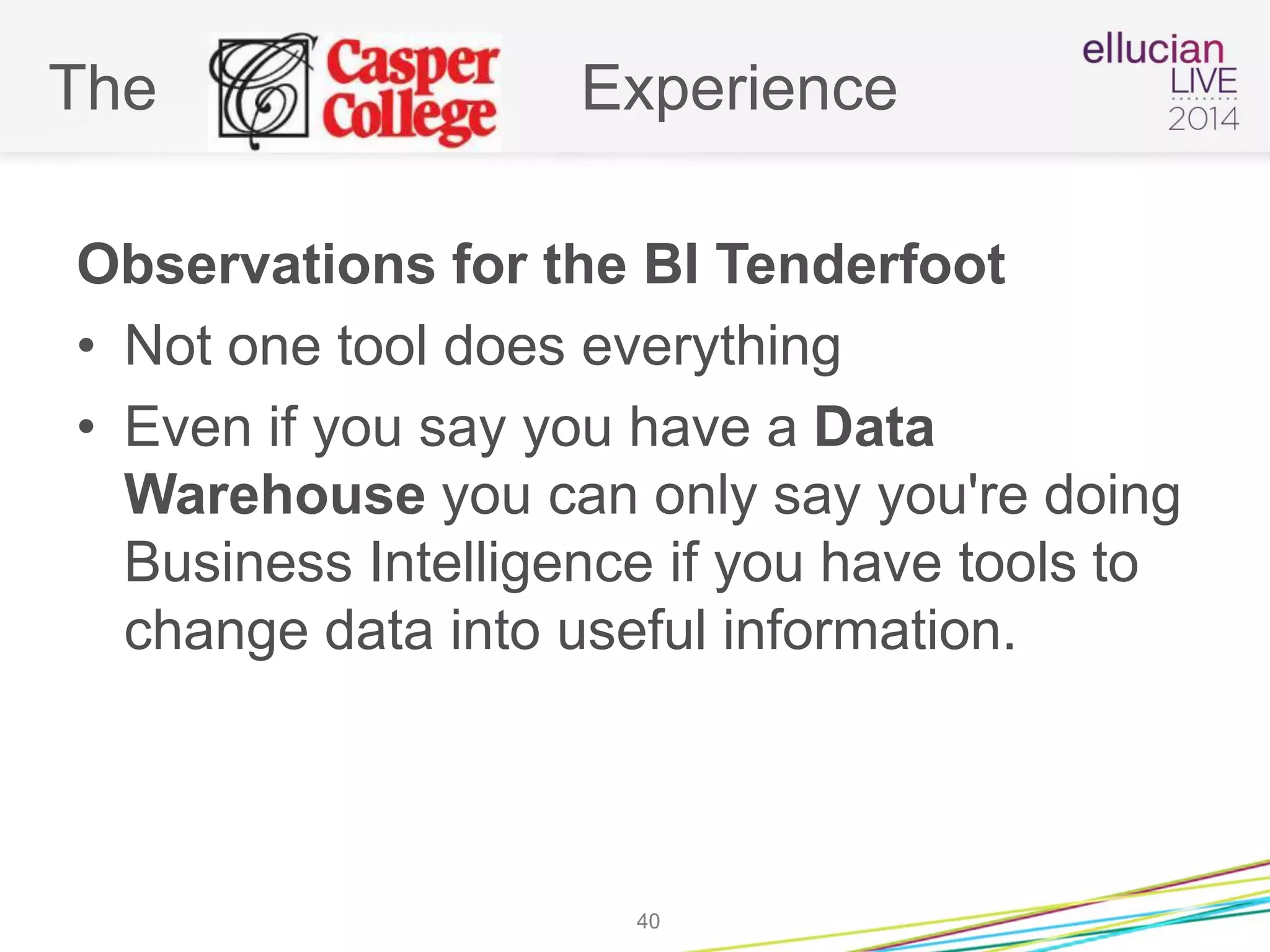

The Experience
Observations for the BI Tenderfoot
• Not one tool does everything
• Even if you say you have a Data
Warehouse you can only say you're doing
Business Intelligence if you have tools to
change data into useful information.
40
The Experience
Observations for the BI Tenderfoot

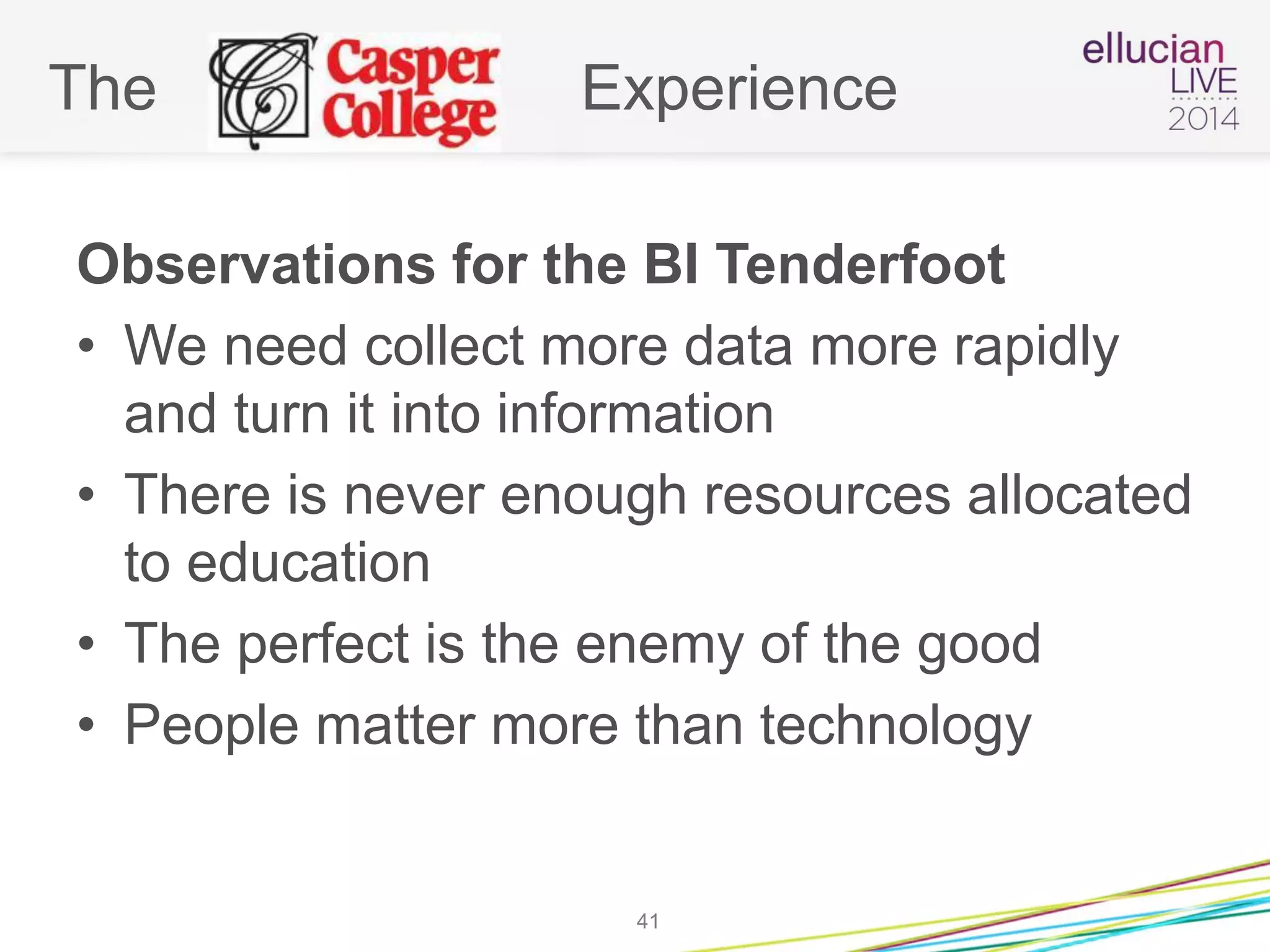

• We need collect more data more rapidly
and turn it into information
• There is never enough resources allocated
to education
• The perfect is the enemy of the good
• People matter more than technology
41
The Experience

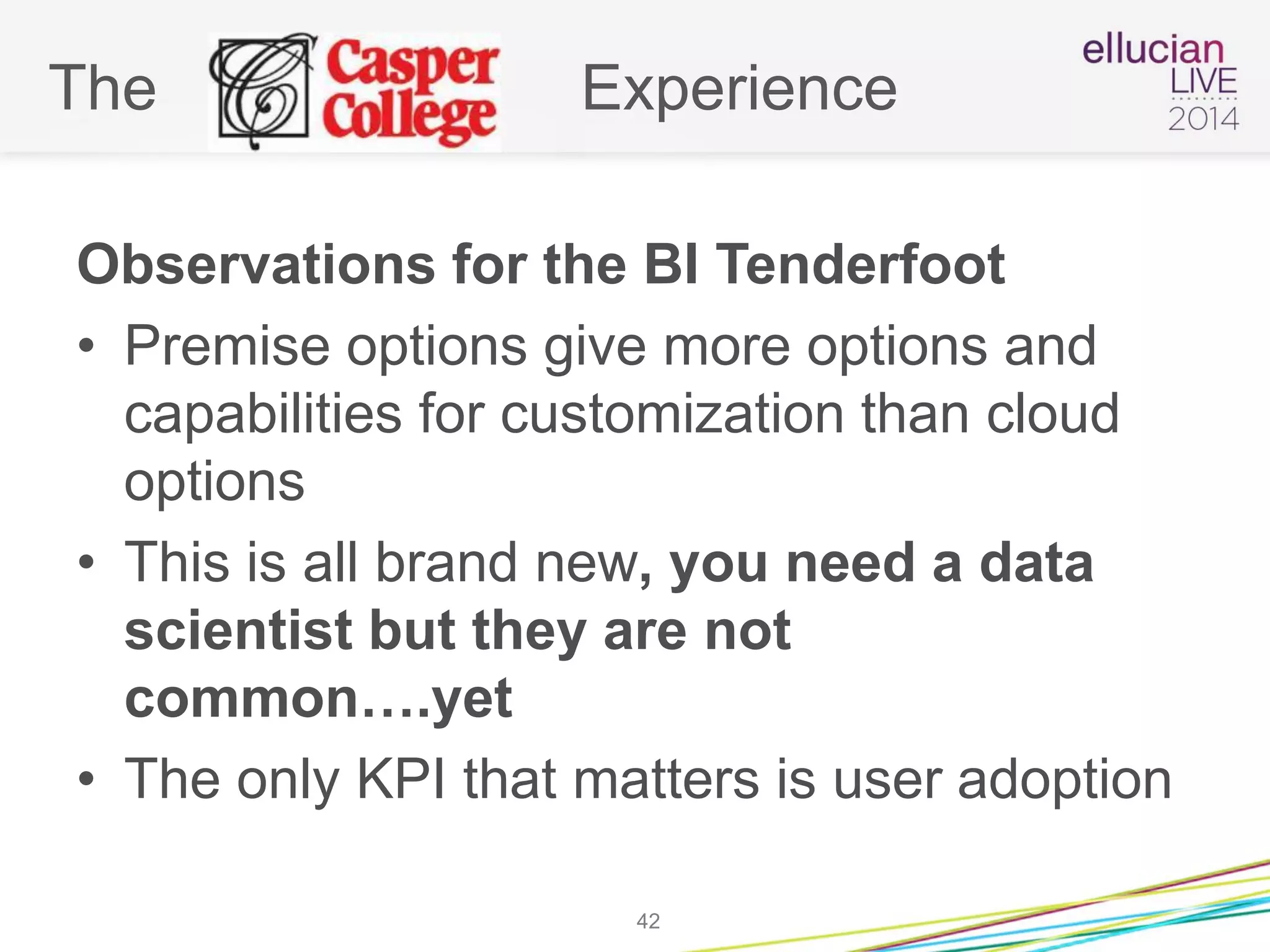

Observations for the BI Tenderfoot
• Premise options give more options and
capabilities for customization than cloud
options
• This is all brand new, you need a data
scientist but they are not
common….yet
• The only KPI that matters is user adoption
42
The Experience

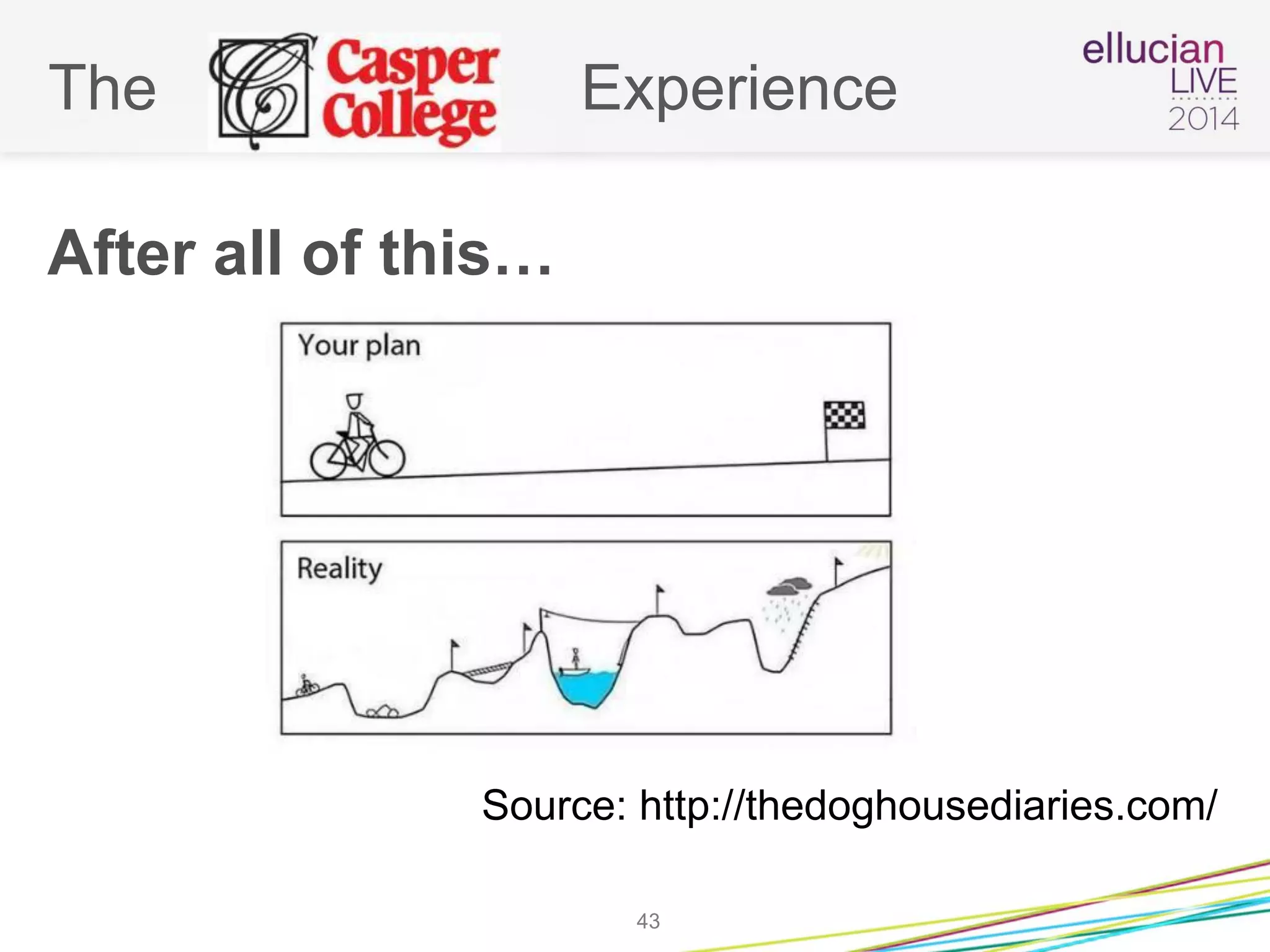

After all of this…
43
Source: http://thedoghousediaries.com/
The Experience

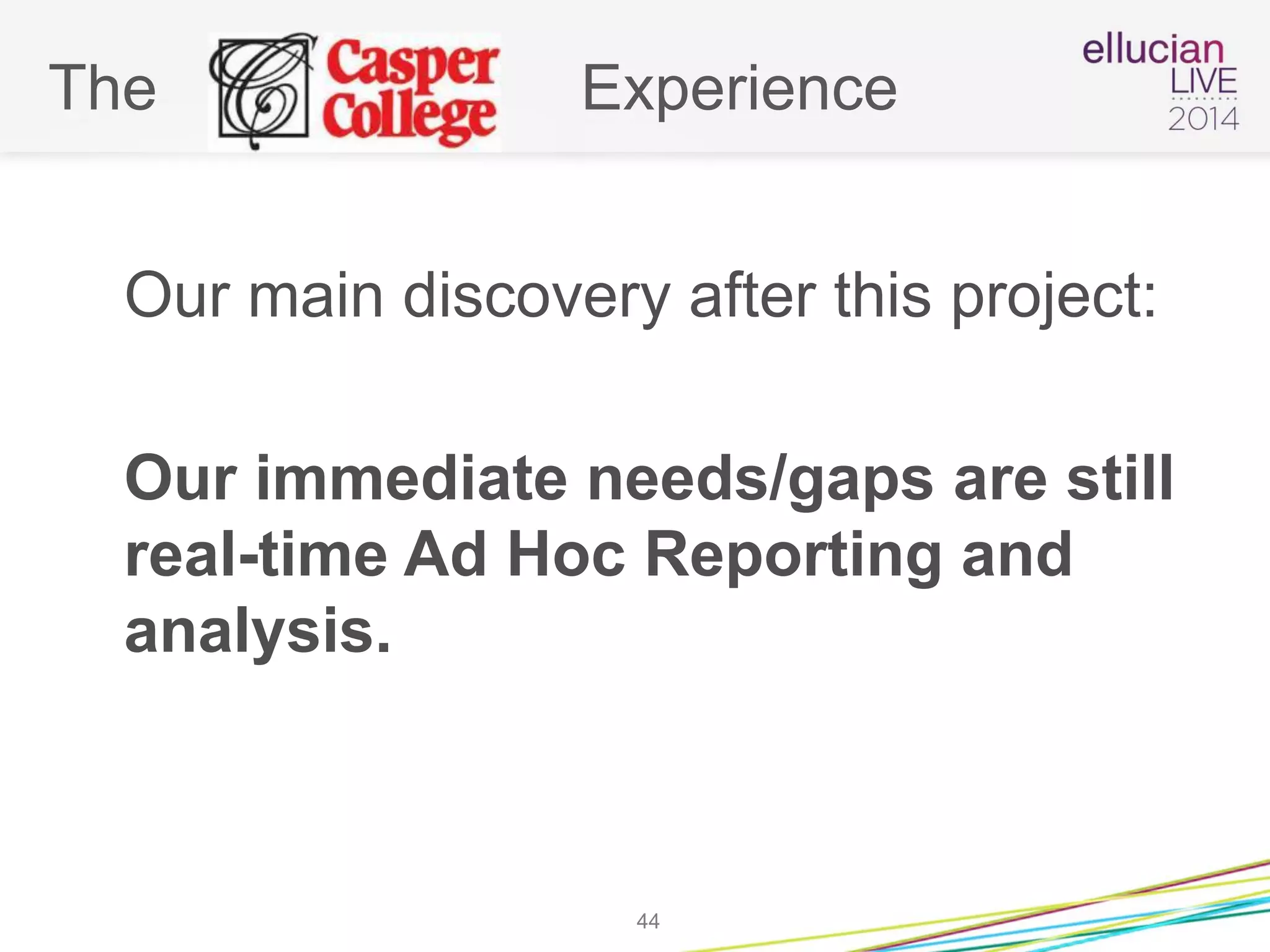

Our main discovery after this project:
Our immediate needs/gaps are still
real-time Ad Hoc Reporting and
analysis.
44

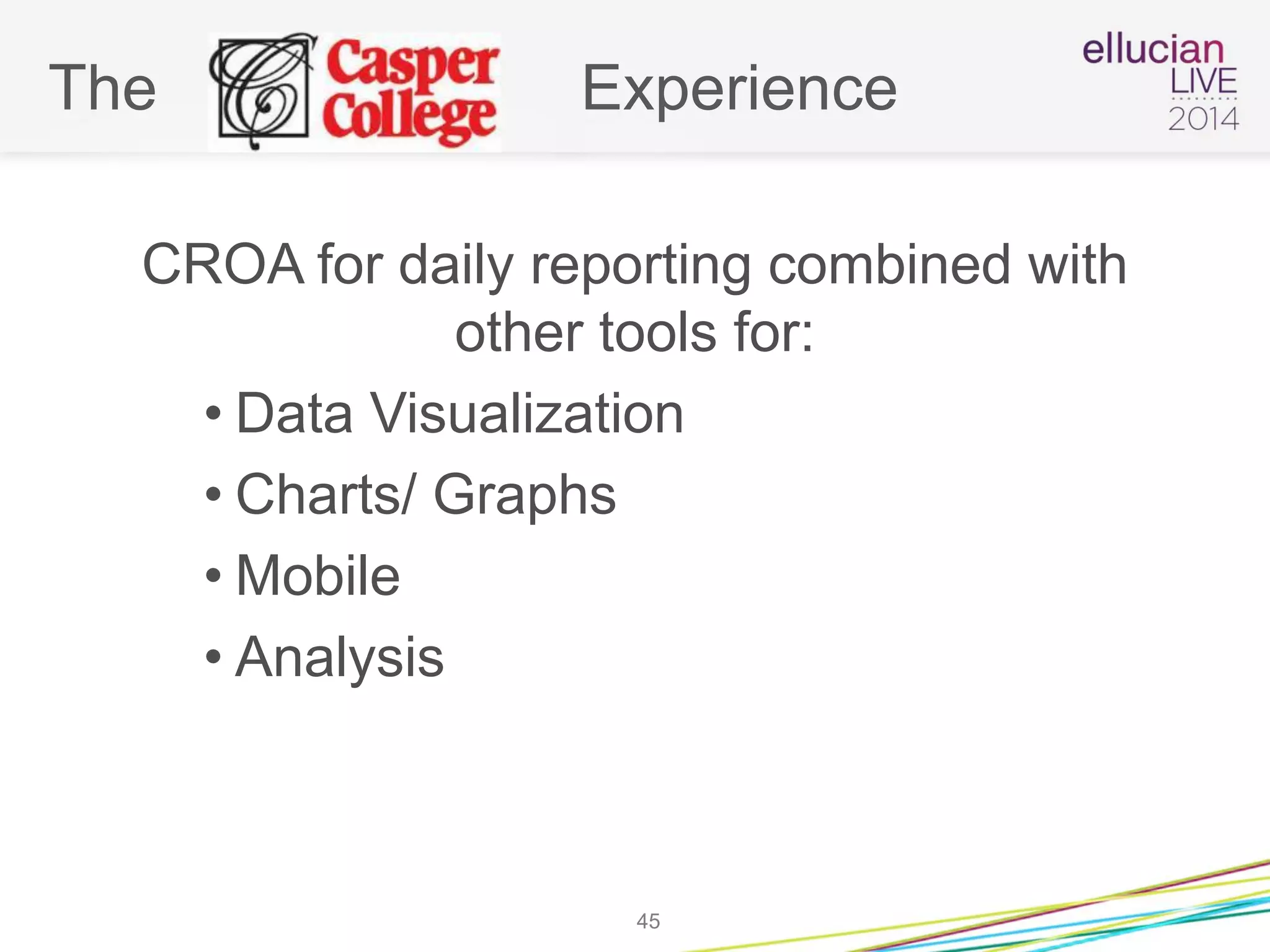

The Experience
CROA for daily reporting combined with
other tools for:
• Data Visualization
• Charts/ Graphs
• Mobile
• Analysis
45

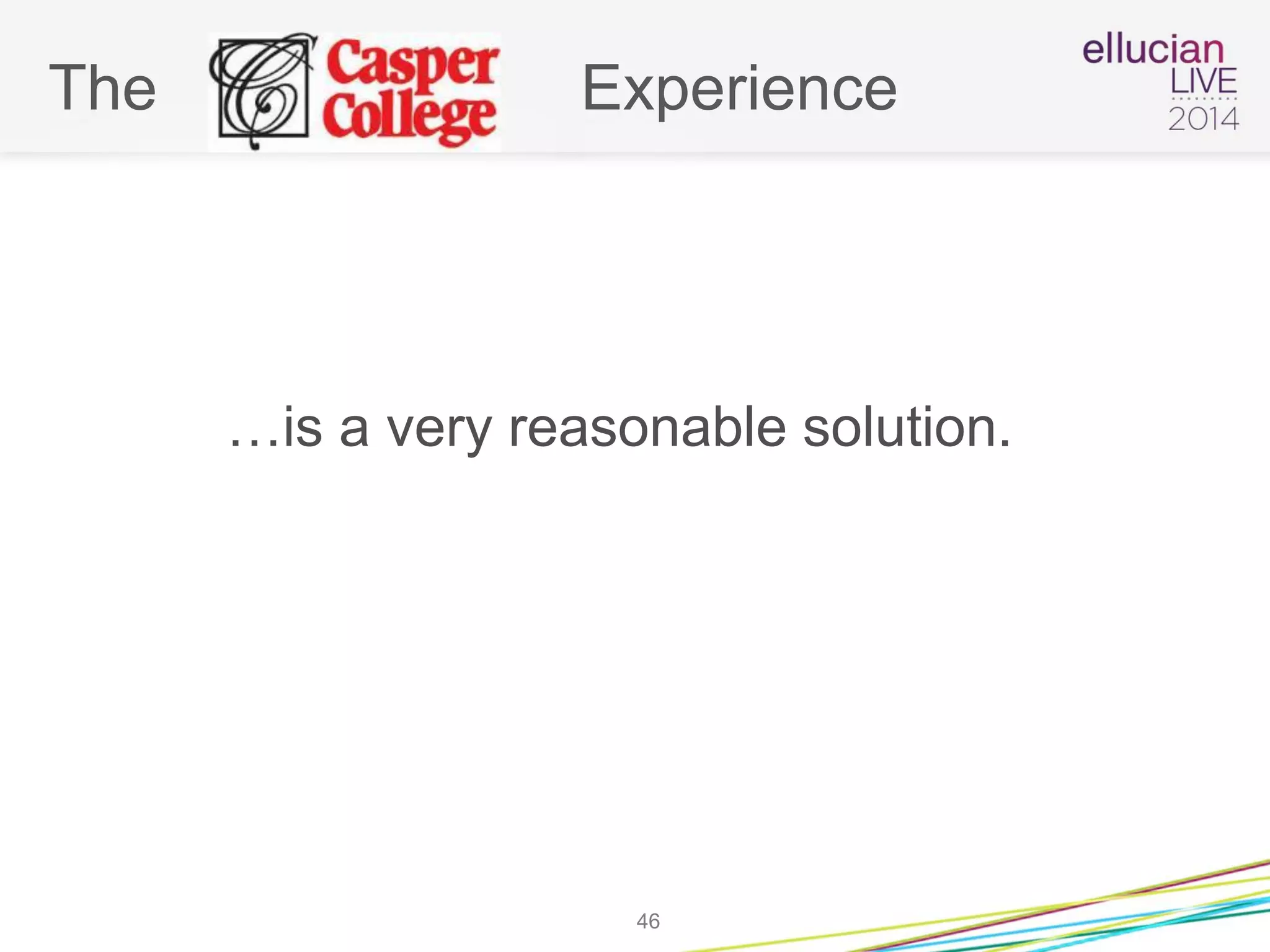

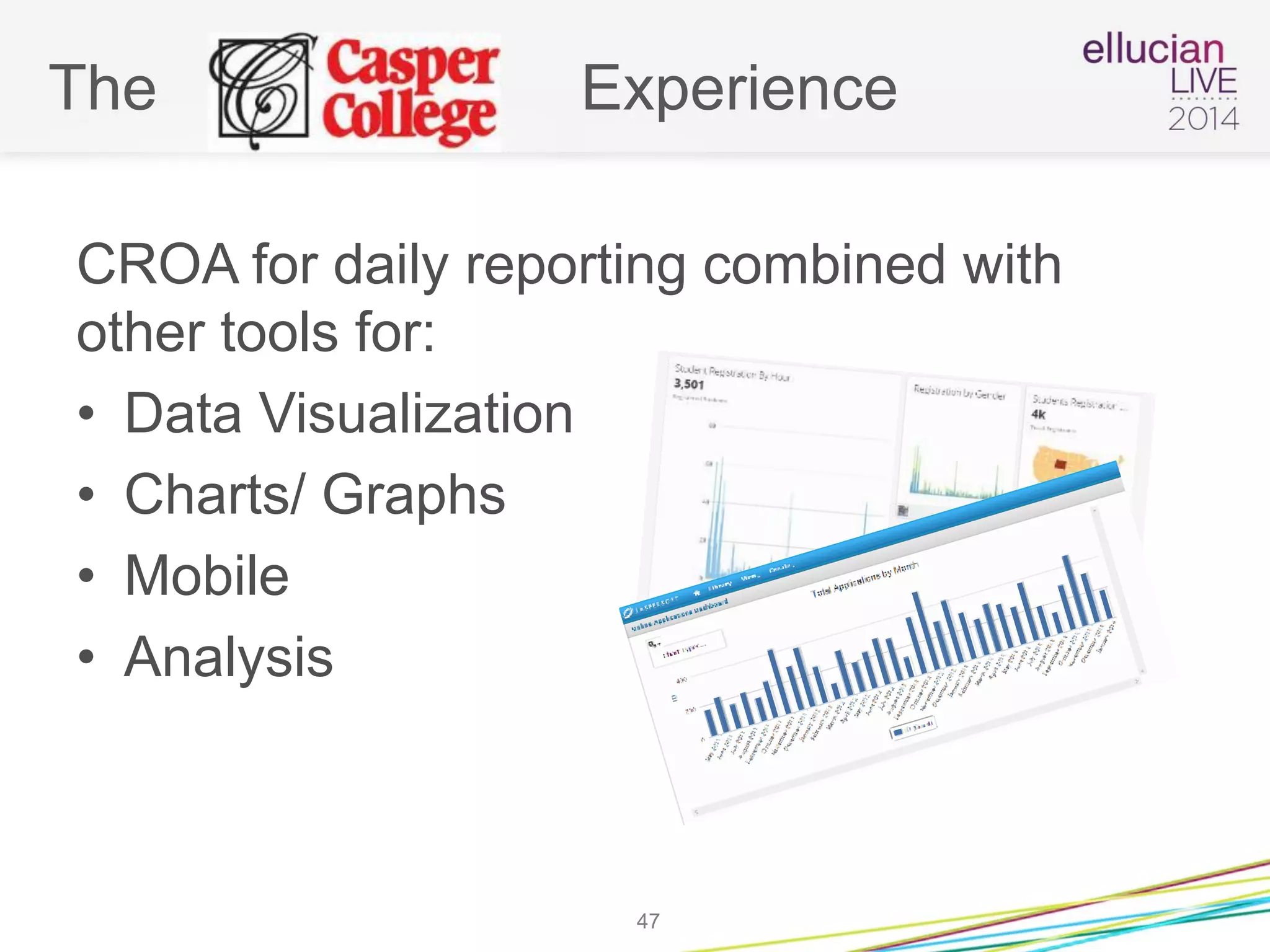

The Experience
…is a very reasonable solution.
46
The Experience
CROA for daily reporting combined with
other tools for:
• Data Visualization
• Charts/ Graphs
• Mobile
• Analysis
47

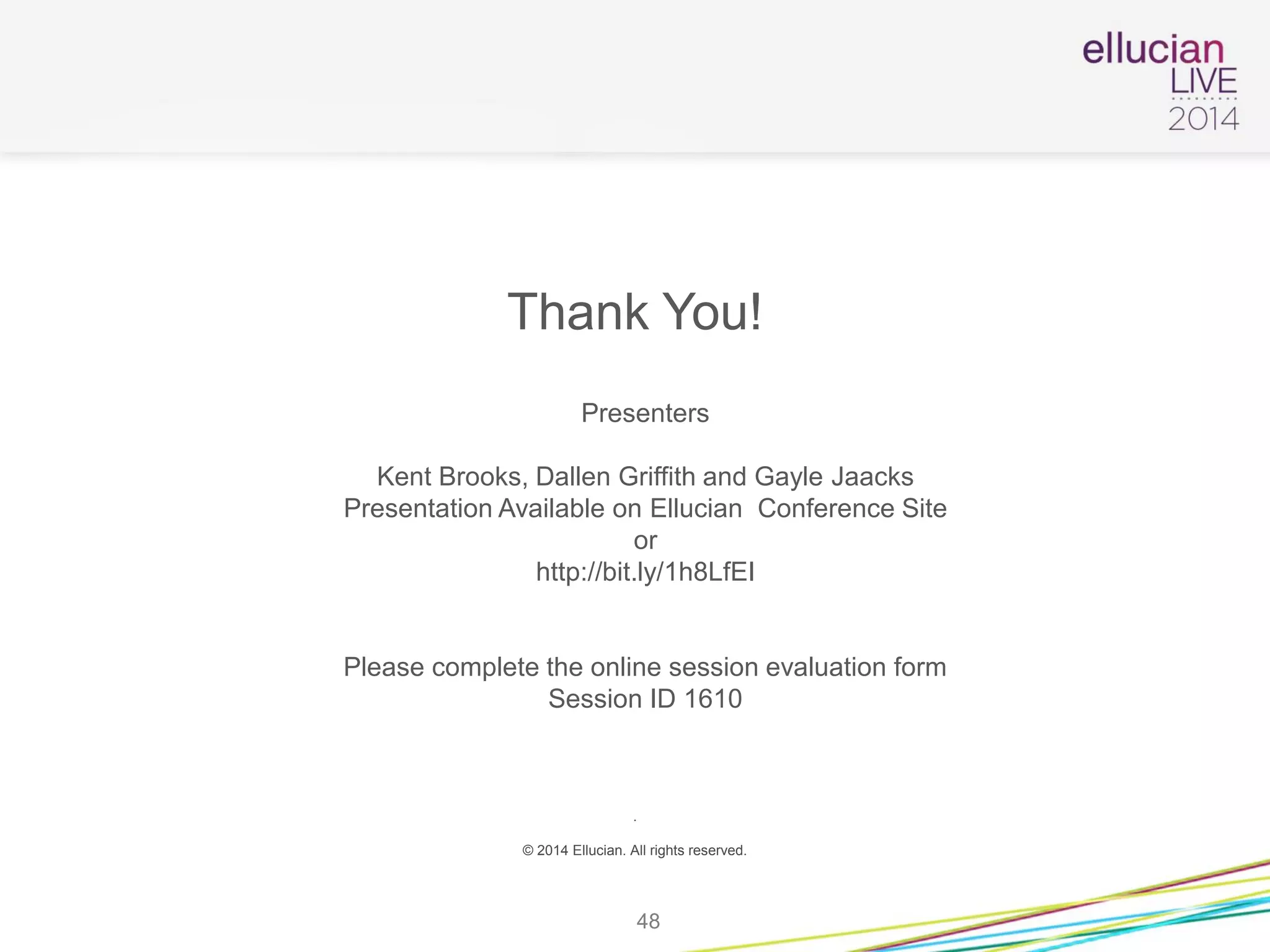

Thank You!
Presenters
Kent Brooks, Dallen Griffith and Gayle Jaacks
Presentation Available on Ellucian Conference Site
or
http://bit.ly/1h8LfEI
Please complete the online session evaluation form
Session ID 1610
.
© 2014 Ellucian. All rights reserved.
48

Ellucian Live 2014 Presentation on Reporting and BI

  • 1.
    Presented by: Kent Brooksand Dallen Griffith Casper Wyoming Community College Gayle Jaacks, Ellucian Sr. Project Manager, Ellucian April 7, 2014 Session ID 1610 Seven Colleges’ Journey to one Statewide Reporting System
  • 2.
    Session Rules ofEtiquette • Please turn off your cell phone/pager • If you must leave the session early, please do so as discreetly as possible • Please avoid side conversation during the session Thank you for your cooperation! 2
  • 3.
    Session Rules ofEtiquette • Conference Hashtag #elive14 • @kentbrooks • @dallengriffith Thank you! 3
  • 4.
    Agenda • State ofWyoming Commission Project Goals • Wyoming Environment • Project Time Line • Project Phases • Describe Solution • Lessons Learned 4
  • 5.
  • 6.
    Seven Colleges’ Journeyto One Statewide Reporting System Problem: • State Commission Office provides aggregate reports to multiple state, federal and regulatory entities. • Timing, consistency and accuracy were ongoing challenges. • Commission frequently wrote reports and delivered to all colleges to run to attempt to gain efficiency and consistency. . 6
  • 7.
    Project Goals: • Migrateall seven community colleges to SQL platform. • Design a standard data set for each college to send to the Commission Office. • Design a reporting system to allow the Commission office to report on behalf of the colleges to multiple constituencies. • Provide all Institutional Research Offices the same data conventions for cumulative reporting and sharing reports. 7
  • 8.
  • 9.
  • 10.
    Wyoming Community CollegeSystem • Seven Community Colleges • 20+ years on Colleague Unidata • College’s historically attempted to maintain the same validation and code file naming conventions. • Institutional Research offices worked collaboratively to define a standard reporting data set. 10
  • 11.
  • 12.
    Solution • Simultaneously migrateall colleges to Colleague SQL Environment • Implement Business Objects , ODS and Dashboard for each campus and the Commission Office • Design a standard data set to accommodate reports • Develop data standards • Design a system to transmit data from the Colleges to the Commission for reporting. 12
  • 13.
  • 14.
    Planning PhaseI Business ObjectTraining & Consulting Business Objects Consulting SQL Migraiton - Data Cleansing and Custom Preparation TIMELINE PROJECT TIMELINE JulyMayAprilMarchFebJan.Nov.Oct.SeptAug Dec June 18 Month Project ALL Campuses LIVE on CROA and migrated to SQL
  • 15.
    Deploy State-wide Reporting Commission WarehouseAssessment TIMELINE PROJECT TIMELINE JulyMayAprilMarchFebJan.Nov.Oct.SeptAug Dec June 18 Months
  • 16.
  • 17.
    CROA Architecture –Another Viewpoint Colleague Universe Metadata Crystal Reports InfoView Web Intelligence Dashboards Operational Data Store SQL
  • 18.
    Centralized ODS @Wyoming CCC ODS ODS ODS ODS ODS ODS ODS CC CWC EWC LCCC NWC NWCCD WWCC BU BU BU BU BU BU BU Create State Subset SQL DB Back Ups CC CWC EWC LCCC NWC NWCC D WWCC Back Ups Uploaded to WCCC ODS Server WCC C Secure Transmission to WCCC
  • 19.
  • 20.
    The Experience 20 Kent Brooksand Dallen Griffith
  • 21.
    The Experience • PhaseI Uni Data to SQL – Hardware/ Software – Data Preparation – Custom Applications – Test Migration/ Testing – Go Live 21
  • 22.
    The Experience • Hardware/Software –Hp 3000 Chassis – We installed basics • OS • SQL – Ellucian Installed and Setup Colleague 22
  • 23.
    The Experience • DataPreparation – Start as soon as possible – Long Process – Don’t Be afraid. – Be Aggressive – Get end users involved – DMIG will still find errors. 23
  • 24.
    The Experience • CustomApplications – Re-think Processes – Great opportunity – CROA – We failed to migrate a few key programs 24
  • 25.
    The Experience • TestMigration/ Testing – First Migration Took a Week – Test Plan – Held end users hand. 25
  • 26.
    The Experience • GoLive – Started Friday 5:00 PM – DMIG failed – Hyper links – Phased Approach to releasing new system 26
  • 27.
    The Experience • PhaseII CROA Implementation – Hardware/Software – Training – ETL – Testing/Go Live – State Reporting System 27
  • 28.
    The Experience • Hardware/Software –Same HP Hardware – We Installed OS and SQL – Ellucian installed CROA and Built DB 28
  • 29.
    The Experience • Training –Took Recommended classes – Paid for extra consulting time 29
  • 30.
    The Experience • ETL –Built in to Ellucian – Resolve errors frequently 30
  • 31.
    The Experience • Testing/ Go Live – Run alongside Query builder – Did this Migration during migration to sql 31
  • 32.
    The Experience • StateReporting – Test Site – Most work was done by Ellucian – Separate db – Common IR universe 32
  • 33.
    The Experience • PhaseIII – Beyond CROA to Business Intelligence 33
  • 34.
    The Experience “We don’thave enough data….the sample size is too small” -Moneyball 34
  • 35.
    The Experience The DataChallenge (Part 1) • We have Web Intelligence but are lacking the ability to create reports from our whole data set. • SAP( for example) = good daily reports but no ad hoc, no visualization no dashboards 35
  • 36.
    The Experience The DataChallenge (Part 2) • We are being asked to be wise stewards of state resources about a field that is brand new • The skills we are being asked to learn to do this right are in addition to all the other things we must know 36
  • 37.
    The Experience Overcoming theData Challenge • TDWI • BI Scorecard = http://tinyurl.com/l6u76yl • Higher Ed BI Conference = NKU • HEDW = http://www.hedw.org 37
  • 38.
    The Experience Observations forthe BI Tenderfoot • Getting a common set of definitions is important 38
  • 39.
    The Experience Observations forthe BI Tenderfoot • We are decent at collecting data but not at turning data into useful and timely information 39
  • 40.
    The Experience Observations forthe BI Tenderfoot • Not one tool does everything • Even if you say you have a Data Warehouse you can only say you're doing Business Intelligence if you have tools to change data into useful information. 40
  • 41.
    The Experience Observations forthe BI Tenderfoot • We need collect more data more rapidly and turn it into information • There is never enough resources allocated to education • The perfect is the enemy of the good • People matter more than technology 41
  • 42.
    The Experience Observations forthe BI Tenderfoot • Premise options give more options and capabilities for customization than cloud options • This is all brand new, you need a data scientist but they are not common….yet • The only KPI that matters is user adoption 42
  • 43.
    The Experience After allof this… 43 Source: http://thedoghousediaries.com/
  • 44.
    The Experience Our maindiscovery after this project: Our immediate needs/gaps are still real-time Ad Hoc Reporting and analysis. 44
  • 45.
    The Experience CROA fordaily reporting combined with other tools for: • Data Visualization • Charts/ Graphs • Mobile • Analysis 45
  • 46.
    The Experience …is avery reasonable solution. 46
  • 47.
    The Experience CROA fordaily reporting combined with other tools for: • Data Visualization • Charts/ Graphs • Mobile • Analysis 47
  • 48.
    Thank You! Presenters Kent Brooks,Dallen Griffith and Gayle Jaacks Presentation Available on Ellucian Conference Site or http://bit.ly/1h8LfEI Please complete the online session evaluation form Session ID 1610 . © 2014 Ellucian. All rights reserved. 48
