CONTENTS
1. Chapter 1. SOLID WASTE MANAGEMENT.............................................................................................3
1 Waste Management Problem in Addis Ababa .................................................................................3
2 Main Causes of waste Management Problem ..................................................................................3
3 Detail about the Causes of waste Management Problem............................................................3
4 Effects of waste Management Problem..............................................................................................4
5 Means of solution for waste Management Problem .....................................................................4
2. Chapter 2. Requirements Collection.........................................................................................................8
1 Detail Focus Areas Requirements Collection...................................................................................8
I. Urban Settlement Areas .......................................................................................................................8
II. Schools.........................................................................................................................................................8
III. For Houses.............................................................................................................................................8
IV. FOR SCHOOLS......................................................................................................................................9
V. VOLUNTEERS............................................................................................................................................9
3. Chapter 3. PROJECT BUDGET AND ESTIMATION BASICS ..........................................................12

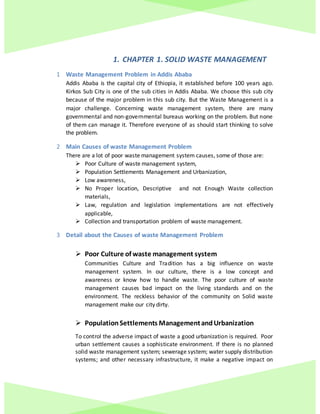

1. CHAPTER 1. SOLID WASTE MANAGEMENT
1 Waste Management Problem in Addis Ababa
Addis Ababa is the capital city of Ethiopia, it established before 100 years ago.
Kirkos Sub City is one of the sub cities in Addis Ababa. We choose this sub city
because of the major problem in this sub city. But the Waste Management is a
major challenge. Concerning waste management system, there are many
governmental and non-governmental bureaus working on the problem. But none
of them can manage it. Therefore everyone of as should start thinking to solve
the problem.
2 Main Causes of waste Management Problem
There are a lot of poor waste management system causes, some of those are:
 Poor Culture of waste management system,
 Population Settlements Management and Urbanization,
 Low awareness,
 No Proper location, Descriptive and not Enough Waste collection
materials,
 Law, regulation and legislation implementations are not effectively
applicable,
 Collection and transportation problem of waste management.
3 Detail about the Causes of waste Management Problem
 Poor Culture of waste management system
Communities Culture and Tradition has a big influence on waste
management system. In our culture, there is a low concept and
awareness or know how to handle waste. The poor culture of waste
management causes bad impact on the living standards and on the
environment. The reckless behavior of the community on Solid waste
management make our city dirty.
 PopulationSettlements ManagementandUrbanization
To control the adverse impact of waste a good urbanization is required. Poor
urban settlement causes a sophisticate environment. If there is no planned
solid waste management system; sewerage system; water supply distribution
systems; and other necessary infrastructure, it make a negative impact on
waste management system. Unplanned population settlement causes
pollution to the environment.
 Low awareness
A low awareness is given concerning waste management from
households, schools, public or private sectors. Every sector leave its
waste disposal outside of its fence.

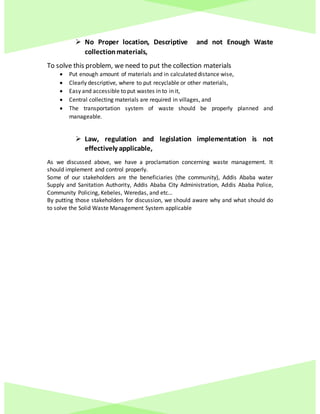

 No Proper location, Descriptive and not Enough Waste
collectionmaterials,
To handle a waste properly, there should be manageable collection
system. It requires to put the collection materials in equal distance and
sufficiently. But in our cases there is collection materials in some corners.
But not properly puts in order to distance; also not inviting to put in to it.
It is not enough to handle the waste.
 Law, regulation and legislation implementation is not
effectively applicable,
There is a proclamation about solid waste management proclamation no.
513/2007. But there is no effective implementation and knowledge of
the proclamation.
4 Effects of waste Management Problem
 It causes health problem for the community;
 It causes a negative environmental impact;
 It make re cycling difficult.
5 Means of solution for waste Management Problem
As we discussed the causes and effects, there are solutions to implement. These
solutions are:-
 Poor Culture of waste management systemand Low
awareness
To develop a good traditions and awareness the solution is education. Teaching and
practices should be done in every family, community, schools, in public or in private
sectors. Everyone needs to be responsible to manage every disposals of waste. By
making traditions, we will make our environment clean.
 No Proper location, Descriptive and not Enough Waste
collectionmaterials,
To solve this problem, we need to put the collection materials
 Put enough amount of materials and in calculated distance wise,
 Clearly descriptive, where to put recyclable or other materials,
 Easy and accessible to put wastes in to in it,
 Central collecting materials are required in villages, and
 The transportation system of waste should be properly planned and
manageable.
 Law, regulation and legislation implementation is not
effectively applicable,
As we discussed above, we have a proclamation concerning waste management. It
should implement and control properly.
Some of our stakeholders are the beneficiaries (the community), Addis Ababa water
Supply and Sanitation Authority, Addis Ababa City Administration, Addis Ababa Police,
Community Policing, Kebeles, Weredas, and etc…
By putting those stakeholders for discussion, we should aware why and what should do
to solve the Solid Waste Management System applicable

I. 1. General Project Information
Project Name: SOLID WASTE DISPOSAL
Executive Sponsors: Cherkos Subcity Adminstration
Department Sponsor:
Impact of project: To create a better solid waste desposal system and safe,clean and healthyenvironment.
II. 2. Project Team
III. Name Department Telephone E-mail
Project
Manager:
Team
Members:
1. Tsedey
2. Saba Yimer
3. Mulugeta Yirdaw
4. Biruh Mulugeta
5. Bethelehem
Samson
6. Marsha Nega
IV. 3. Stakeholders (e.g., thosewith a significant interest in or who will besignificantly affected by this project)
1. Cherkos Subcity’s Society
2. Cherkos Subcity Adminstration
3. School deans and Students
4. Reagulatoryand Legislative Bodies
V. 4. Project Scope Statement
ProjectPurpose
The purpose of the SOLID WASTE DISPOSAL Project is to ensure solid waste is managed in such a way
that protects both public health and the environment. This project works hard to help all societies of
Cherkos Subcity to manage better their solid wastes.
Objectives (in business terms) Describe the measurable outcomes of the project, e.g., reduce costby xxxx orincrease quality toyyyy
To ensure clean city that protects both public health and the environment by delivering waste collecting
materials in short distance gap and awaring the society and students together with city administration
and other stakeholders.
Deliverables List the high-level “products” to be created(e.g., improvedxxxx process, employeemanual onyyyy)
Creating clean and green city
Scope List what the projectwill andwill notaddress (e.g., this projectaddresses units thatreport into theOffice of Executive Vice President. Units
that report into the Provosts Office are not included)
This projectwill consistofcreating a clean city by delivering waste collecting materials and byawaing Kirkos sub city socity
and students. Money comics on our website.The project will be completed untill August15, 2020.
ProjectMilestones Propose start and end dates forProject Phases (e.g., Inception, Planning, Construction, Delivery) and othermajormilestones
This projectwill start January 1, 2020 and ends untill August15 2020
Major Known Risks (includingsignificant Assumptions) Identify obstacles that may cause the project tofail.
Risk Risk Rating (Hi, Med, Lo)
By a poor beaurocrasyofstakeholders High
If the communityis unwillng to cooperate Medium
Constraints List any conditions that may limit the project team’s options with respectto resources, personnel, orschedule (e.g., predetermined
budget orproject enddate, limit onnumberof staff thatmay beassignedto the project).
Budgetis the mostcritical constraintof this projectand also lack of communitycooperation may also be a big challenge .
External Dependencies Will project success depend oncoordination of efforts betweenthe project team andoneormore otherindividuals or
groups?Has everyone involved agreedto this interaction?
VI. 5. Communication Strategy (specify how the projectmanager willcommunicate to the Executive Sponsor,Project Team members and
Stakeholders, e.g.,frequency ofstatus reports, frequency ofProjectTeam meetings, etc.
Communicates bydaily,weekly and monthlystatus reports.
Communicates bymeetings.
Communicates byphone calls.
VII. 6. Sign-off
VIII. IX. Name X. Signature XI. Date
(MM/DD
/YYYY)
XII. Executive Sponsor
XIII. Department Sponsor
XIV. Project Manager
XV. 7. Notes

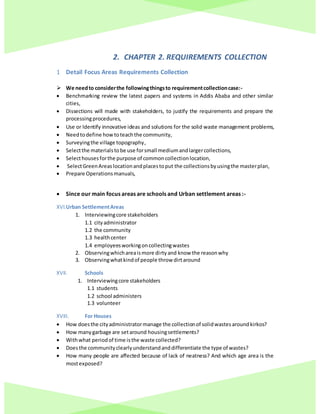

2. CHAPTER 2. REQUIREMENTS COLLECTION
1 Detail Focus Areas Requirements Collection
 We needto considerthe followingthingsto requirementcollectioncase:-
 Benchmarking review the latest papers and systems in Addis Ababa and other similar
cities,
 Dissections will made with stakeholders, to justify the requirements and prepare the
processingprocedures,
 Use or Identify innovative ideas and solutions for the solid waste management problems,
 Needtodefine howtoteachthe community,
 Surveyingthe village topography,
 Selectthe materialstobe use forsmall mediumandlargercollections,
 Selecthousesforthe purpose of commoncollectionlocation,
 SelectGreenAreaslocationandplacestoput the collectionsbyusingthe masterplan,
 Prepare Operationsmanuals,
 Since our main focus areas are schools and Urban settlement areas :-
XVI.Urban SettlementAreas
1. Interviewingcore stakeholders
1.1 cityadministrator
1.2 the community
1.3 healthcenter
1.4 employeesworkingoncollectingwastes
2. Observingwhichareaismore dirtyand know the reasonwhy
3. Observingwhatkindof people throw dirtaround
XVII. Schools
1. Interviewingcore stakeholders
1.1 students
1.2 school administers
1.3 volunteer
XVIII. For Houses
 How doesthe cityadministratormanage the collectionof solidwastesaroundkirkos?
 How manygarbage are setaround housingsettlements?
 Withwhat periodof time isthe waste collected?
 Doesthe communityclearlyunderstandanddifferentiate the type of wastes?
 How many people are affected because of lack of neatness? And which age area is the
mostexposed?

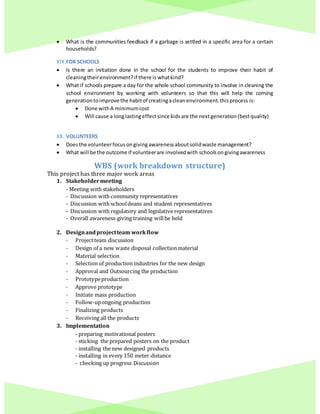

 What is the communities feedback if a garbage is settled in a specific area for a certain
households?
XIX.FOR SCHOOLS
 Is there an initiation done in the school for the students to improve their habit of
cleaningtheirenvironment?if there is whatkind?
 What if schools prepare a day for the whole school community to involve in cleaning the
school environment by working with volunteers so that this will help the coming
generationtoimprove the habitof creatingacleanenvironment.thisprocess is:
 Done withA minimumcost
 Will cause a longlastingeffectsince kidsare the nextgeneration(bestquality)
XX. VOLUNTEERS
 Doesthe volunteerfocusongivingawarenessaboutsolidwaste management?
 What will be the outcome if volunteerare involvedwith schoolsongivingawareness
WBS (work breakdown structure)
This project has three major work areas
1. Stakeholdermeeting
- Meeting with stakeholders
- Discussion with community representatives
- Discussion with schooldeans and student representatives
- Discussion with regulatory and legislative representatives
- Overall awareness giving training willbe held
2. Designandprojectteam workflow
- Projectteam discussion
- Design of a new waste disposal collectionmaterial
- Material selection
- Selection of production industries for the new design
- Approval and Outsourcing the production
- Prototypeproduction
- Approve prototype
- Initiate mass production
- Follow-upongoing production
- Finalizing products
- Receiving all the products
3. Implementation
- preparing motivational posters
- sticking the prepared posters on the product
- installing the new designed products
- installing in every 150 meter distance
- checking up progress Discussion

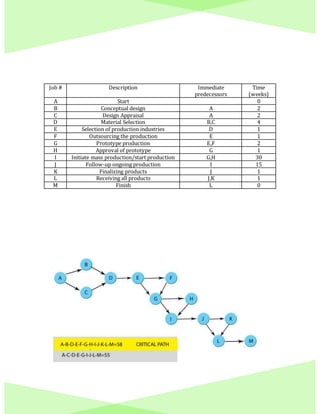

Job # Description Immediate
predecessors
Time
(weeks)
A Start 0
B Conceptual design A 2
C Design Appraisal A 2
D Material Selection B,C 4
E Selection of production industries D 1
F Outsourcing the production E 1
G Prototype production E,F 2
H Approval of prototype G 1
I Initiate mass production/start production G,H 30
J Follow-up ongoing production I 15
K Finalizing products J 1
L Receiving all products J,K 1
M Finish L 0
3. CHAPTER 3. PROJECT BUDGET AND
ESTIMATION BASICS
Estimating of project budget is essential, therefore we here estimate the rough
estimation of our project.
Cost is require for a lot things. Some of these costs are for following purposes
 For stakeholder meeting purposes
 Allowances,
 Coffee, tea and other ceremonies
 other un seen events and fees
 for Innovationand sample materials preparation
 reviewing computing innovative ideas
 Selecting and preparing materials
 other unseen payments and contingencies
 Implementing the project
 It takes the major cost of the project
To summarize the above cases we use the following table
Temporary Rough Cost Estimation
Type Cost in Birr
stakeholder meetings 1,500,000.00
Innovation and sample material preparation 3,000,000.00
Implementation of the project 45,000,000.00
Sub Total 49,500,000.00
10% contingencies 4,950,000.00
20% Management contingencies 9,900,000.00
15% VAT 7,425,000.00
Total Amount of Cost 71,775,000.00
The rough estimated cost of our project is 71,775,000.00 ( Seventy One Million
Seven Hundred Seventy Five Thousands Birr Only)

Edited solid waste managment

  • 2.
    CONTENTS 1. Chapter 1.SOLID WASTE MANAGEMENT.............................................................................................3 1 Waste Management Problem in Addis Ababa .................................................................................3 2 Main Causes of waste Management Problem ..................................................................................3 3 Detail about the Causes of waste Management Problem............................................................3 4 Effects of waste Management Problem..............................................................................................4 5 Means of solution for waste Management Problem .....................................................................4 2. Chapter 2. Requirements Collection.........................................................................................................8 1 Detail Focus Areas Requirements Collection...................................................................................8 I. Urban Settlement Areas .......................................................................................................................8 II. Schools.........................................................................................................................................................8 III. For Houses.............................................................................................................................................8 IV. FOR SCHOOLS......................................................................................................................................9 V. VOLUNTEERS............................................................................................................................................9 3. Chapter 3. PROJECT BUDGET AND ESTIMATION BASICS ..........................................................12
  • 3.
    1. CHAPTER 1.SOLID WASTE MANAGEMENT 1 Waste Management Problem in Addis Ababa Addis Ababa is the capital city of Ethiopia, it established before 100 years ago. Kirkos Sub City is one of the sub cities in Addis Ababa. We choose this sub city because of the major problem in this sub city. But the Waste Management is a major challenge. Concerning waste management system, there are many governmental and non-governmental bureaus working on the problem. But none of them can manage it. Therefore everyone of as should start thinking to solve the problem. 2 Main Causes of waste Management Problem There are a lot of poor waste management system causes, some of those are:  Poor Culture of waste management system,  Population Settlements Management and Urbanization,  Low awareness,  No Proper location, Descriptive and not Enough Waste collection materials,  Law, regulation and legislation implementations are not effectively applicable,  Collection and transportation problem of waste management. 3 Detail about the Causes of waste Management Problem  Poor Culture of waste management system Communities Culture and Tradition has a big influence on waste management system. In our culture, there is a low concept and awareness or know how to handle waste. The poor culture of waste management causes bad impact on the living standards and on the environment. The reckless behavior of the community on Solid waste management make our city dirty.  PopulationSettlements ManagementandUrbanization To control the adverse impact of waste a good urbanization is required. Poor urban settlement causes a sophisticate environment. If there is no planned solid waste management system; sewerage system; water supply distribution systems; and other necessary infrastructure, it make a negative impact on
  • 4.
    waste management system.Unplanned population settlement causes pollution to the environment.  Low awareness A low awareness is given concerning waste management from households, schools, public or private sectors. Every sector leave its waste disposal outside of its fence.  No Proper location, Descriptive and not Enough Waste collectionmaterials, To handle a waste properly, there should be manageable collection system. It requires to put the collection materials in equal distance and sufficiently. But in our cases there is collection materials in some corners. But not properly puts in order to distance; also not inviting to put in to it. It is not enough to handle the waste.  Law, regulation and legislation implementation is not effectively applicable, There is a proclamation about solid waste management proclamation no. 513/2007. But there is no effective implementation and knowledge of the proclamation. 4 Effects of waste Management Problem  It causes health problem for the community;  It causes a negative environmental impact;  It make re cycling difficult. 5 Means of solution for waste Management Problem As we discussed the causes and effects, there are solutions to implement. These solutions are:-  Poor Culture of waste management systemand Low awareness To develop a good traditions and awareness the solution is education. Teaching and practices should be done in every family, community, schools, in public or in private sectors. Everyone needs to be responsible to manage every disposals of waste. By making traditions, we will make our environment clean.
  • 5.
     No Properlocation, Descriptive and not Enough Waste collectionmaterials, To solve this problem, we need to put the collection materials  Put enough amount of materials and in calculated distance wise,  Clearly descriptive, where to put recyclable or other materials,  Easy and accessible to put wastes in to in it,  Central collecting materials are required in villages, and  The transportation system of waste should be properly planned and manageable.  Law, regulation and legislation implementation is not effectively applicable, As we discussed above, we have a proclamation concerning waste management. It should implement and control properly. Some of our stakeholders are the beneficiaries (the community), Addis Ababa water Supply and Sanitation Authority, Addis Ababa City Administration, Addis Ababa Police, Community Policing, Kebeles, Weredas, and etc… By putting those stakeholders for discussion, we should aware why and what should do to solve the Solid Waste Management System applicable
  • 6.
    I. 1. GeneralProject Information Project Name: SOLID WASTE DISPOSAL Executive Sponsors: Cherkos Subcity Adminstration Department Sponsor: Impact of project: To create a better solid waste desposal system and safe,clean and healthyenvironment. II. 2. Project Team III. Name Department Telephone E-mail Project Manager: Team Members: 1. Tsedey 2. Saba Yimer 3. Mulugeta Yirdaw 4. Biruh Mulugeta 5. Bethelehem Samson 6. Marsha Nega IV. 3. Stakeholders (e.g., thosewith a significant interest in or who will besignificantly affected by this project) 1. Cherkos Subcity’s Society 2. Cherkos Subcity Adminstration 3. School deans and Students 4. Reagulatoryand Legislative Bodies V. 4. Project Scope Statement ProjectPurpose The purpose of the SOLID WASTE DISPOSAL Project is to ensure solid waste is managed in such a way that protects both public health and the environment. This project works hard to help all societies of Cherkos Subcity to manage better their solid wastes. Objectives (in business terms) Describe the measurable outcomes of the project, e.g., reduce costby xxxx orincrease quality toyyyy To ensure clean city that protects both public health and the environment by delivering waste collecting materials in short distance gap and awaring the society and students together with city administration and other stakeholders. Deliverables List the high-level “products” to be created(e.g., improvedxxxx process, employeemanual onyyyy) Creating clean and green city
  • 7.
    Scope List whatthe projectwill andwill notaddress (e.g., this projectaddresses units thatreport into theOffice of Executive Vice President. Units that report into the Provosts Office are not included) This projectwill consistofcreating a clean city by delivering waste collecting materials and byawaing Kirkos sub city socity and students. Money comics on our website.The project will be completed untill August15, 2020. ProjectMilestones Propose start and end dates forProject Phases (e.g., Inception, Planning, Construction, Delivery) and othermajormilestones This projectwill start January 1, 2020 and ends untill August15 2020 Major Known Risks (includingsignificant Assumptions) Identify obstacles that may cause the project tofail. Risk Risk Rating (Hi, Med, Lo) By a poor beaurocrasyofstakeholders High If the communityis unwillng to cooperate Medium Constraints List any conditions that may limit the project team’s options with respectto resources, personnel, orschedule (e.g., predetermined budget orproject enddate, limit onnumberof staff thatmay beassignedto the project). Budgetis the mostcritical constraintof this projectand also lack of communitycooperation may also be a big challenge . External Dependencies Will project success depend oncoordination of efforts betweenthe project team andoneormore otherindividuals or groups?Has everyone involved agreedto this interaction? VI. 5. Communication Strategy (specify how the projectmanager willcommunicate to the Executive Sponsor,Project Team members and Stakeholders, e.g.,frequency ofstatus reports, frequency ofProjectTeam meetings, etc. Communicates bydaily,weekly and monthlystatus reports. Communicates bymeetings. Communicates byphone calls. VII. 6. Sign-off VIII. IX. Name X. Signature XI. Date (MM/DD /YYYY) XII. Executive Sponsor XIII. Department Sponsor XIV. Project Manager XV. 7. Notes
  • 8.
    2. CHAPTER 2.REQUIREMENTS COLLECTION 1 Detail Focus Areas Requirements Collection  We needto considerthe followingthingsto requirementcollectioncase:-  Benchmarking review the latest papers and systems in Addis Ababa and other similar cities,  Dissections will made with stakeholders, to justify the requirements and prepare the processingprocedures,  Use or Identify innovative ideas and solutions for the solid waste management problems,  Needtodefine howtoteachthe community,  Surveyingthe village topography,  Selectthe materialstobe use forsmall mediumandlargercollections,  Selecthousesforthe purpose of commoncollectionlocation,  SelectGreenAreaslocationandplacestoput the collectionsbyusingthe masterplan,  Prepare Operationsmanuals,  Since our main focus areas are schools and Urban settlement areas :- XVI.Urban SettlementAreas 1. Interviewingcore stakeholders 1.1 cityadministrator 1.2 the community 1.3 healthcenter 1.4 employeesworkingoncollectingwastes 2. Observingwhichareaismore dirtyand know the reasonwhy 3. Observingwhatkindof people throw dirtaround XVII. Schools 1. Interviewingcore stakeholders 1.1 students 1.2 school administers 1.3 volunteer XVIII. For Houses  How doesthe cityadministratormanage the collectionof solidwastesaroundkirkos?  How manygarbage are setaround housingsettlements?  Withwhat periodof time isthe waste collected?  Doesthe communityclearlyunderstandanddifferentiate the type of wastes?  How many people are affected because of lack of neatness? And which age area is the mostexposed?
  • 9.
     What isthe communities feedback if a garbage is settled in a specific area for a certain households? XIX.FOR SCHOOLS  Is there an initiation done in the school for the students to improve their habit of cleaningtheirenvironment?if there is whatkind?  What if schools prepare a day for the whole school community to involve in cleaning the school environment by working with volunteers so that this will help the coming generationtoimprove the habitof creatingacleanenvironment.thisprocess is:  Done withA minimumcost  Will cause a longlastingeffectsince kidsare the nextgeneration(bestquality) XX. VOLUNTEERS  Doesthe volunteerfocusongivingawarenessaboutsolidwaste management?  What will be the outcome if volunteerare involvedwith schoolsongivingawareness WBS (work breakdown structure) This project has three major work areas 1. Stakeholdermeeting - Meeting with stakeholders - Discussion with community representatives - Discussion with schooldeans and student representatives - Discussion with regulatory and legislative representatives - Overall awareness giving training willbe held 2. Designandprojectteam workflow - Projectteam discussion - Design of a new waste disposal collectionmaterial - Material selection - Selection of production industries for the new design - Approval and Outsourcing the production - Prototypeproduction - Approve prototype - Initiate mass production - Follow-upongoing production - Finalizing products - Receiving all the products 3. Implementation - preparing motivational posters - sticking the prepared posters on the product - installing the new designed products - installing in every 150 meter distance - checking up progress Discussion
  • 11.
    Job # DescriptionImmediate predecessors Time (weeks) A Start 0 B Conceptual design A 2 C Design Appraisal A 2 D Material Selection B,C 4 E Selection of production industries D 1 F Outsourcing the production E 1 G Prototype production E,F 2 H Approval of prototype G 1 I Initiate mass production/start production G,H 30 J Follow-up ongoing production I 15 K Finalizing products J 1 L Receiving all products J,K 1 M Finish L 0
  • 12.
    3. CHAPTER 3.PROJECT BUDGET AND ESTIMATION BASICS Estimating of project budget is essential, therefore we here estimate the rough estimation of our project. Cost is require for a lot things. Some of these costs are for following purposes  For stakeholder meeting purposes  Allowances,  Coffee, tea and other ceremonies  other un seen events and fees  for Innovationand sample materials preparation  reviewing computing innovative ideas  Selecting and preparing materials  other unseen payments and contingencies  Implementing the project  It takes the major cost of the project To summarize the above cases we use the following table Temporary Rough Cost Estimation Type Cost in Birr stakeholder meetings 1,500,000.00 Innovation and sample material preparation 3,000,000.00 Implementation of the project 45,000,000.00 Sub Total 49,500,000.00 10% contingencies 4,950,000.00 20% Management contingencies 9,900,000.00 15% VAT 7,425,000.00 Total Amount of Cost 71,775,000.00
  • 13.
    The rough estimatedcost of our project is 71,775,000.00 ( Seventy One Million Seven Hundred Seventy Five Thousands Birr Only)
