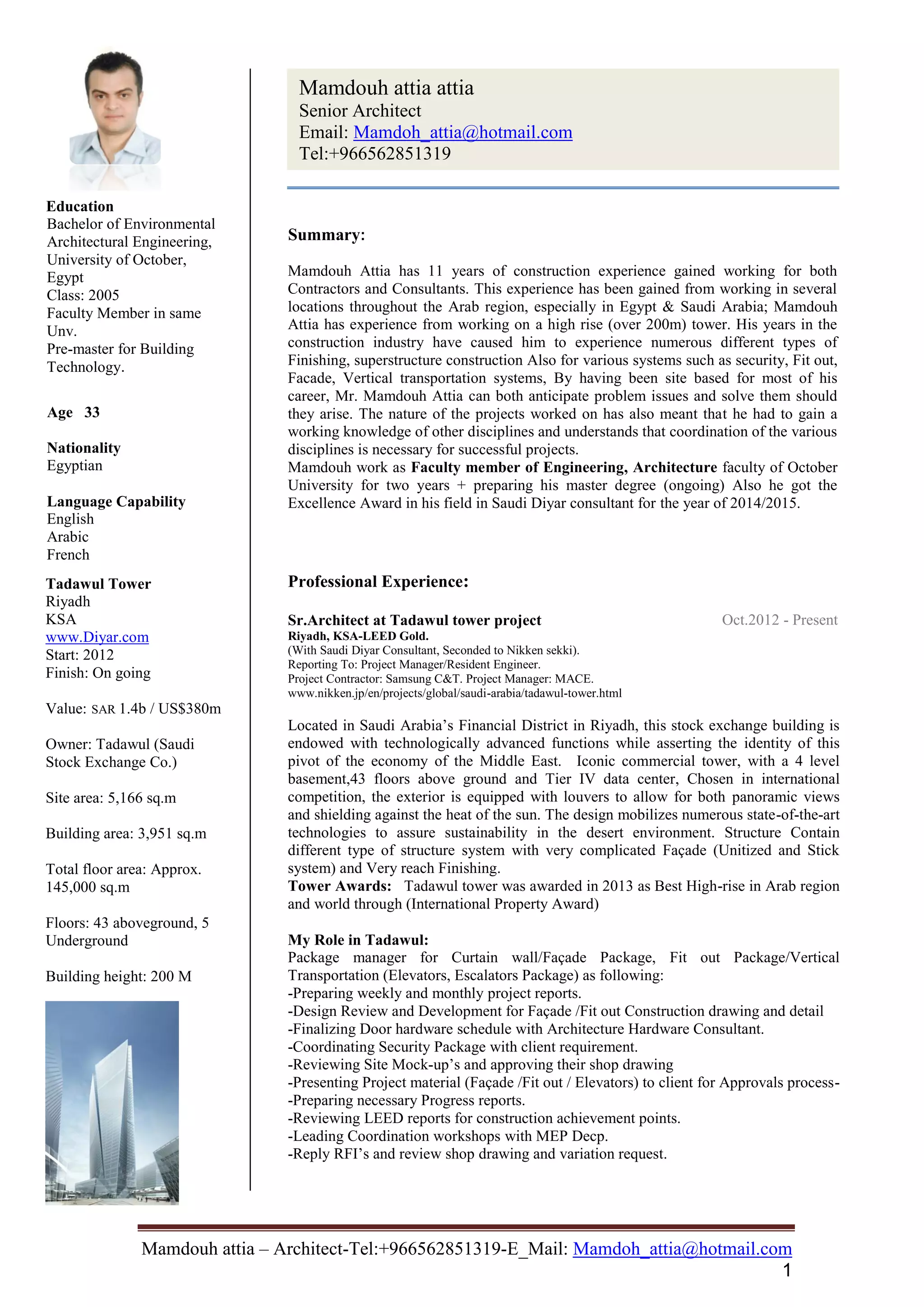

Mamdoh_attia@hotmail.comE_Mail:-Tel:+966562851319-Architect–Mamdouh attia
1
Education
Bachelor of Environmental
Architectural Engineering,
University of October,
Egypt
Class: 2005
Faculty Member in same
Unv.
Pre-master for Building
Technology.
Age 33
Nationality
Egyptian
Language Capability
English
Arabic
French
Summary:
Mamdouh Attia has 11 years of construction experience gained working for both
Contractors and Consultants. This experience has been gained from working in several
locations throughout the Arab region, especially in Egypt & Saudi Arabia; Mamdouh
Attia has experience from working on a high rise (over 200m) tower. His years in the
construction industry have caused him to experience numerous different types of
Finishing, superstructure construction Also for various systems such as security, Fit out,
Facade, Vertical transportation systems, By having been site based for most of his
career, Mr. Mamdouh Attia can both anticipate problem issues and solve them should
they arise. The nature of the projects worked on has also meant that he had to gain a
working knowledge of other disciplines and understands that coordination of the various
disciplines is necessary for successful projects.
Mamdouh work as Faculty member of Engineering, Architecture faculty of October
University for two years + preparing his master degree (ongoing) Also he got the
Excellence Award in his field in Saudi Diyar consultant for the year of 2014/2015.
Professional Experience:
Sr.Architect at Tadawul tower project
Riyadh, KSA-LEED Gold.
(With Saudi Diyar Consultant, Seconded to Nikken sekki).
Reporting To: Project Manager/Resident Engineer.
Project Contractor: Samsung C&T. Project Manager: MACE.
www.nikken.jp/en/projects/global/saudi-arabia/tadawul-tower.html
Located in Saudi Arabia’s Financial District in Riyadh, this stock exchange building is
endowed with technologically advanced functions while asserting the identity of this
pivot of the economy of the Middle East. Iconic commercial tower, with a 4 level
basement,43 floors above ground and Tier IV data center, Chosen in international
competition, the exterior is equipped with louvers to allow for both panoramic views
and shielding against the heat of the sun. The design mobilizes numerous state-of-the-art
technologies to assure sustainability in the desert environment. Structure Contain
different type of structure system with very complicated Façade (Unitized and Stick
system) and Very reach Finishing.
Tower Awards: Tadawul tower was awarded in 2013 as Best High-rise in Arab region
and world through (International Property Award)
My Role in Tadawul:
Package manager for Curtain wall/Façade Package, Fit out Package/Vertical
Transportation (Elevators, Escalators Package) as following:
-Preparing weekly and monthly project reports.
-Design Review and Development for Façade /Fit out Construction drawing and detail
-Finalizing Door hardware schedule with Architecture Hardware Consultant.
-Coordinating Security Package with client requirement.
-Reviewing Site Mock-up’s and approving their shop drawing
-Presenting Project material (Façade /Fit out / Elevators) to client for Approvals process-
-Preparing necessary Progress reports.
-Reviewing LEED reports for construction achievement points.
-Leading Coordination workshops with MEP Decp.
-Reply RFI’s and review shop drawing and variation request.
Tadawul Tower
Riyadh
KSA
www.Diyar.com
Start: 2012
Finish: On going
Value: SAR 1.4b / US$380m
Owner: Tadawul (Saudi
Stock Exchange Co.)
Site area: 5,166 sq.m
Building area: 3,951 sq.m
Total floor area: Approx.
145,000 sq.m
Floors: 43 aboveground, 5
Underground
Building height: 200 M
Oct.2012 - Present
Mamdouh attia attia
Senior Architect
Email: Mamdoh_attia@hotmail.com
Tel:+966562851319
Mamdoh_attia@hotmail.comE_Mail:-Tel:+966562851319-Architect–Mamdouh attia
2

Architect at AL-Qasr Mall project
Riyadh, KSA.
With Saudi Diyar Consultant.
Reporting To: Project Manager/Resident Engineer.
Project Contractor: Saudi constructioneers.
www.alqasrmall.com
The mid-southern part of Riyadh city an exciting transformation, witnessing the opening
of one of Riyadh’s most ambitious and dazzling shopping malls. Where Al-Qasr Mall,
designed by Saudi Diyar a big transformation in the Saudi capital. The area has
witnessed a trading momentum and economic stimulant by Al-Qasr residential and
commercial complex and its mall. The mall four-storey building and one basement level,
accommodates a chain of stores, restaurants, and recreational amenities for serving all
family members, with 330 Tenant capacity served by 15 service elevator and 4
Panoramic lifts and 15 service stair with more than 2,000 cars parking space with
special care to handicaps.
Façade of AL qasr mall was first LED lighting Façade in Riyadh with total area more
than 70.0000m2 acting as large screen for Sothern part of the city covered by Aluminum
panel composite section cladding except the entrance area which will be glass curtain
wall (Stick system), The luxurious inside parts of the Mall allows the shopper to walk
into a spacious, sun-drenched atrium with 4 panoramic elevators, 28 escalators, 8
electric paths and 14 elevators connecting all levels and sections of the mall.
My Role in AL-Qasr Mall project:
Working as architect in consultant supervision team with 3 Inspectors, Start from day
one of the project up to handing over with following responsibilities:
-Confirm and control daily site Inspections with Architect’s team.
-Review Material submittals and material Inspection and prepare client presentation.
-Reply RFI’s and review shop drawing and variation request.
-Review and follow up Construction method statement for Fit out, Façade work.
-coordinating with deferent trades ensuring client requirement.
-Attending Daily technical workshop for site daily issues.
-Reviewing Site Mock-up’s and approving their shop drawing.
-Proceed with Handing over process to local authorities.
May2010 - Oct.2012
AL-Qasr Mall
Riyadh
KSA
www.alqasrmall.com
Start: 2010
Finish: End of 2012
Value: SAR 1.1b / US$
375m
Owner: Dar Al-Arkan
Site area: 57.777 sq.m
Total floor area: Approx.
260.000 sq.m
Floors: 4 aboveground, 1
Underground
Building height: 35 M
Site Architect (officer) at mosque and bridge of Masr El sweas road
Cairo, Egypt.
With Corps military engineers.
Reporting To: Area Manager.
Project Contractor: Corps military engineers.
(Acting as site manager)
As one of Corps military engineers projects in Cairo –Mosque and Bridge project was
built as Rush project in 14 months, Mosque encompasses a wide range of both secular
and religious styles from the foundation of Islamic architecture, with 30 meter Height
minaret accessible by spiral stair, an Iconic design was hallmark of Interior space of the
Mosque, parallel to the mosque and as part of development of this area Bridge was built
to assist the rerouting of some roads to avoid clash with Mosque construction, the length
of this bridge was Approx. 1 k.m , with Islamic decoration on bridge body.
My Role in Mosque, bridge project:
Working as site construction manager for the Mosque area, and technical assistance to
bridge construction manager as main contractor under Corps military engineers. From
kick of meeting to handing over stage, with following responsibilities:
-Perform daily site activity according to project plan.
-Supervising and construct Architecture details.
-Developing construction details especially Islamic architecture details.
-Confirm quality of execution.
-Preparing reports and handing over process.
Mosque /Bridge
Cairo
Egypt
Start: 2009
Finish: 2010
Value: 80 m LE/ US$ 10m.
Owner: Corps military
engineers
Site area: 3500 sq.m
Bridge length: 1 km.
Minaret height: 30 m.
Feb.2009 - April.2010
Mamdoh_attia@hotmail.comE_Mail:-Tel:+966562851319-Architect–Mamdouh attia
3
Hospital Dar el shefa
Cairo,
Egypt
Start: 2008
Finish: 2009
Value: 32 m L.E/ US$ 4.5m.
Owner: Ministry of Health
Site area: 10000 sq.m
Number of floors: 5
Number of Bed:200
Site Architect at Dar EL-Shefa Hospital, 200 bed,(Renewal).
Cairo, Egypt.
With Shorpagy CO.
Reporting To: Project Manager.
Project Contractor: Shorpagy CO.
Renewal of Dar El sheaf Hospital, which contains more than 200 bed, Scope of work
was to Renew the building by adding Aluminum cladding to building Façade, and
change all flooring to antibacterial types, and upgrade wall finish ( Stainless and
Vinyl),with special care to different medical departments with various of specialized
consultants.
My Role in Hospital project:
To Execute daily plan work and preparing shop drawing for consultant review and
approval, and controlling daily site activities with project manager as following:
-Preparing site construction detail and Supervising Execution on site.
- Finalizing all technical issues for Intensive care unit with a specialized consultant.
- Coordination with a medical requirement for finishes.
- Hand over the project to hospital team.
Site Engineer at (Office /warehouse building and stuff accommodation
project) -a subcontractor for Schlumberger.
Cairo, Shukeir, Egypt.
With: Swanco oil service.
Reporting To: Area Manager.
Project Contractor: Swanco oil service.
As one of top 3 Oil service companies in the world, Schlumberger decided to build
workshop warehouse to maintain their drilling Equipment’s, include technical Engineers
office within the warehouse, with high acoustic wall properties and specialist finishes
material within warehouse area to comply with their requirement, also stuff
accommodation building in Ras Shukeir (at western cost of Egypt) with 80 studio space
capacity and including standard facilities ( Toilets-Central Kitchen- amusement space)
and 60% of total area as landscape and hardscape .
My Role in Office warehouse project:
Working as construction manager for Office /warehouse building, Responsible for
managing the construction process and ensure project plan with clients on a weekly
basis.
On the other hand I worked as freelance with Schlumberger to develop their stuff
accommodation area in Shukeir area, developing the design and construction detail, and
managing the construction process through subcontractors, so my responsibilities in
Schlumberger projects was as following:
-following daily project plan and manage daily work with subcontractors.
-developing construction detail with consultant team on daily workshop.
-preparing site daily/weekly report for client review.
-managing long lead Items plan and highlighting risk on the project to the client.
-preparing site inspections to consultant on a daily basis.
-preparing monthly payment and submit it to the Consultant.
-preparing close out documents.
-perform handing over process to the client.
Aug.2008 - Feb.2009
Aug.2007 – Aug 2008
Office warehouse building
Cairo
Egypt
Start: 2007
Finish: 2008
Value: 15 m LE/ US$ 2.2m
Owner: Schlumberger
www.slb.com
Site area: 2500m sq.m
Mamdoh_attia@hotmail.comE_Mail:-Tel:+966562851319-Architect–Mamdouh attia
4
Market road project
Luxor
Egypt
Start: 2004
Finish: 2006
Value: 23 m LE/ US$ 3m
Owner: Ministry of defense
http://el-shorbagy.com/
Site area: 3 k.m
SCA projects
Cairo/ Luxor / Alex.
Egypt
Start: 2006
Finish: 2007
Value: 120 m LE/ US$ 16m.
Owner: SCA
http://el-shorbagy.com/
SCA projects (supreme council of antiquities)
As Technical Design Architect
1-Development of archaeological Al sawary pole area( management building +
Lanscaping+monuments restoration) - Alexandria, Egypt.
2- Zoser Pyramid (restoration + Management office area) - Giza, Egypt.
3- Esna temple (restoration + Research to Model Original Temple).
With: Shorpagy CO.
Reporting To: Technical manager.
Project Contractor: Shorpagy CO.
Working as Technical Design Architect, for SCA projects, with Contracting company,
mainly for three projects with Head office team, Designing and building the Landscape /
hardscape, and design and built the office management area (ticket building /stuff
building), supporting the Unesco team in restoration Research.
My Role in SCA projects project:
-Design management building and prepare presentation to consultant and clients.
-draw and develop construction detail in detail design stage.
-Preparing a monthly report about each project and make a presentation to clients.
-supporting Unesco team in restoration research.
-review monthly payments came from each site in head office.
-perform monthly Technical Inspection with Technical manger to monitor Quality.
-preparing close out documents.
-perform handing over process to the client.
july.2006 – Aug 2007
Site Technical Engineer Renewal and Development of Market road.
Design and built project
Luxor- Egypt.
With: Shorpagy CO.
Reporting To: Project Manager.
Project Contractor: Shorpagy CO.
This project one of Famous projects in Luxor city, Ministry of Defense decide to support
development of Luxor city, Under Renewal and development of this city, Market Road
area was developed by reestablishing the concept of Road design and unifying shop
front elevation also adding setting area and cafe shop for the visitors and stamped
concrete flooring with different patterns and providing semi-shaded space with historical
Entrance gate reflects the value of history of the city.
My Role in Marker Road project:
Working as site Technical Architect to support design team to design setting area and
hardscape and Entrance gate also arranging daily site work with subcontractors to reflect
design concept to site as built condition, and presenting the construction detail to site
team – detail responsibilities was as following:
-participate design work and develop construction detail to meet as built condition.
-preparing site daily/weekly report for client review.
-preparing site inspections to the consultant on a daily basis.
-preparing construction shop drawing and review with design team.
-preparing close out documents.
-perform handing over process to the client.
April.2005 – July 2006
Mamdoh_attia@hotmail.comE_Mail:-Tel:+966562851319-Architect–Mamdouh attia
5
KEY SKILLS
- Sufficient knowledge in intelligent building solutions and drawing production.
- Design talent corresponding with innovation.
- Strong knowledge about Ironmongery and Doors Design and Fabrication.
- Experience in designing security concept in office buildings.
- Expertise in CAD administration and management
- Quality Management in Project Execution as well as Project Design
- Sustainable & Environmental Design Solutions
- Commercial, Residential, Retail, Industrial, Administration, Education and
Hospitality project experience.
- Computer Aided Design skills; AutoCAD 2d, Sketch up3D, Adobe Photoshop
& MS Project
- Sufficient knowledge of IBC and NFPA-SBC-ANSI-ASTM Codes and
Regulations
- Good knowledge to solve Claims and Leading Design variation process during
construction.
International Experience:
 Curtain walls design development and technical review for unitized cold
pending system along with Smart blinds with International company’s such as
(Permastlissa) – Italy ’’Venice’’ during 2012,2013.
 Curtain wall Testing Preparation and Inspection for Unitized and stick system,
with International Firms such as (Arup – japan) / (Nikken Sekki- Japan).
 Tiling (Ceramic / Stone) factory and Material Inspection and selection process
From A to Z (Italy – Spain),2014/2015.
 Confirmation and Developing Elevator Caps design and Elevator/Escalators
system, and confirmation of the factory and Mock-up preparation and selection
in Switzerland (January-2015 / December 2016).
 Custom glass material developing during Fabrication process with German
Companies as (Interpan) during 2014.
 Curtain Wall International seminars in Holland (Amsterdam) during 2014.
 Aluminum Extrusion Profiles developing systems, and Inspecting Extrusion
Factories, and Confirming Extrusion testing, (Athena Greece,2014).
 Safety Design in Building Workshop conference, Fire protection and
Evacuation Strategies – Dubai 2016.
Reference Person:
-Jan hencken (NIKKEN Senior Project Manager- Email: hencken.jan@nikken.jp
-Brian Eshmade : MACE SR.Pr.Manager– E mail: Brian.Eshmade@macegroup.com
-Wessam Ahmed:Diyar Resident Engineer –Email: Wesam.Ahmed@diyar.com.
End
Professional Affiliation
- Member Arab council For
Engineers.
- Egyptians Council for Engineers
- Saudi Council for Engineers
Worked For

CV.2016

  • 1.
    Mamdoh_attia@hotmail.comE_Mail:-Tel:+966562851319-Architect–Mamdouh attia 1 Education Bachelor ofEnvironmental Architectural Engineering, University of October, Egypt Class: 2005 Faculty Member in same Unv. Pre-master for Building Technology. Age 33 Nationality Egyptian Language Capability English Arabic French Summary: Mamdouh Attia has 11 years of construction experience gained working for both Contractors and Consultants. This experience has been gained from working in several locations throughout the Arab region, especially in Egypt & Saudi Arabia; Mamdouh Attia has experience from working on a high rise (over 200m) tower. His years in the construction industry have caused him to experience numerous different types of Finishing, superstructure construction Also for various systems such as security, Fit out, Facade, Vertical transportation systems, By having been site based for most of his career, Mr. Mamdouh Attia can both anticipate problem issues and solve them should they arise. The nature of the projects worked on has also meant that he had to gain a working knowledge of other disciplines and understands that coordination of the various disciplines is necessary for successful projects. Mamdouh work as Faculty member of Engineering, Architecture faculty of October University for two years + preparing his master degree (ongoing) Also he got the Excellence Award in his field in Saudi Diyar consultant for the year of 2014/2015. Professional Experience: Sr.Architect at Tadawul tower project Riyadh, KSA-LEED Gold. (With Saudi Diyar Consultant, Seconded to Nikken sekki). Reporting To: Project Manager/Resident Engineer. Project Contractor: Samsung C&T. Project Manager: MACE. www.nikken.jp/en/projects/global/saudi-arabia/tadawul-tower.html Located in Saudi Arabia’s Financial District in Riyadh, this stock exchange building is endowed with technologically advanced functions while asserting the identity of this pivot of the economy of the Middle East. Iconic commercial tower, with a 4 level basement,43 floors above ground and Tier IV data center, Chosen in international competition, the exterior is equipped with louvers to allow for both panoramic views and shielding against the heat of the sun. The design mobilizes numerous state-of-the-art technologies to assure sustainability in the desert environment. Structure Contain different type of structure system with very complicated Façade (Unitized and Stick system) and Very reach Finishing. Tower Awards: Tadawul tower was awarded in 2013 as Best High-rise in Arab region and world through (International Property Award) My Role in Tadawul: Package manager for Curtain wall/Façade Package, Fit out Package/Vertical Transportation (Elevators, Escalators Package) as following: -Preparing weekly and monthly project reports. -Design Review and Development for Façade /Fit out Construction drawing and detail -Finalizing Door hardware schedule with Architecture Hardware Consultant. -Coordinating Security Package with client requirement. -Reviewing Site Mock-up’s and approving their shop drawing -Presenting Project material (Façade /Fit out / Elevators) to client for Approvals process- -Preparing necessary Progress reports. -Reviewing LEED reports for construction achievement points. -Leading Coordination workshops with MEP Decp. -Reply RFI’s and review shop drawing and variation request. Tadawul Tower Riyadh KSA www.Diyar.com Start: 2012 Finish: On going Value: SAR 1.4b / US$380m Owner: Tadawul (Saudi Stock Exchange Co.) Site area: 5,166 sq.m Building area: 3,951 sq.m Total floor area: Approx. 145,000 sq.m Floors: 43 aboveground, 5 Underground Building height: 200 M Oct.2012 - Present Mamdouh attia attia Senior Architect Email: Mamdoh_attia@hotmail.com Tel:+966562851319
  • 2.
    Mamdoh_attia@hotmail.comE_Mail:-Tel:+966562851319-Architect–Mamdouh attia 2 Architect atAL-Qasr Mall project Riyadh, KSA. With Saudi Diyar Consultant. Reporting To: Project Manager/Resident Engineer. Project Contractor: Saudi constructioneers. www.alqasrmall.com The mid-southern part of Riyadh city an exciting transformation, witnessing the opening of one of Riyadh’s most ambitious and dazzling shopping malls. Where Al-Qasr Mall, designed by Saudi Diyar a big transformation in the Saudi capital. The area has witnessed a trading momentum and economic stimulant by Al-Qasr residential and commercial complex and its mall. The mall four-storey building and one basement level, accommodates a chain of stores, restaurants, and recreational amenities for serving all family members, with 330 Tenant capacity served by 15 service elevator and 4 Panoramic lifts and 15 service stair with more than 2,000 cars parking space with special care to handicaps. Façade of AL qasr mall was first LED lighting Façade in Riyadh with total area more than 70.0000m2 acting as large screen for Sothern part of the city covered by Aluminum panel composite section cladding except the entrance area which will be glass curtain wall (Stick system), The luxurious inside parts of the Mall allows the shopper to walk into a spacious, sun-drenched atrium with 4 panoramic elevators, 28 escalators, 8 electric paths and 14 elevators connecting all levels and sections of the mall. My Role in AL-Qasr Mall project: Working as architect in consultant supervision team with 3 Inspectors, Start from day one of the project up to handing over with following responsibilities: -Confirm and control daily site Inspections with Architect’s team. -Review Material submittals and material Inspection and prepare client presentation. -Reply RFI’s and review shop drawing and variation request. -Review and follow up Construction method statement for Fit out, Façade work. -coordinating with deferent trades ensuring client requirement. -Attending Daily technical workshop for site daily issues. -Reviewing Site Mock-up’s and approving their shop drawing. -Proceed with Handing over process to local authorities. May2010 - Oct.2012 AL-Qasr Mall Riyadh KSA www.alqasrmall.com Start: 2010 Finish: End of 2012 Value: SAR 1.1b / US$ 375m Owner: Dar Al-Arkan Site area: 57.777 sq.m Total floor area: Approx. 260.000 sq.m Floors: 4 aboveground, 1 Underground Building height: 35 M Site Architect (officer) at mosque and bridge of Masr El sweas road Cairo, Egypt. With Corps military engineers. Reporting To: Area Manager. Project Contractor: Corps military engineers. (Acting as site manager) As one of Corps military engineers projects in Cairo –Mosque and Bridge project was built as Rush project in 14 months, Mosque encompasses a wide range of both secular and religious styles from the foundation of Islamic architecture, with 30 meter Height minaret accessible by spiral stair, an Iconic design was hallmark of Interior space of the Mosque, parallel to the mosque and as part of development of this area Bridge was built to assist the rerouting of some roads to avoid clash with Mosque construction, the length of this bridge was Approx. 1 k.m , with Islamic decoration on bridge body. My Role in Mosque, bridge project: Working as site construction manager for the Mosque area, and technical assistance to bridge construction manager as main contractor under Corps military engineers. From kick of meeting to handing over stage, with following responsibilities: -Perform daily site activity according to project plan. -Supervising and construct Architecture details. -Developing construction details especially Islamic architecture details. -Confirm quality of execution. -Preparing reports and handing over process. Mosque /Bridge Cairo Egypt Start: 2009 Finish: 2010 Value: 80 m LE/ US$ 10m. Owner: Corps military engineers Site area: 3500 sq.m Bridge length: 1 km. Minaret height: 30 m. Feb.2009 - April.2010
  • 3.
    Mamdoh_attia@hotmail.comE_Mail:-Tel:+966562851319-Architect–Mamdouh attia 3 Hospital Darel shefa Cairo, Egypt Start: 2008 Finish: 2009 Value: 32 m L.E/ US$ 4.5m. Owner: Ministry of Health Site area: 10000 sq.m Number of floors: 5 Number of Bed:200 Site Architect at Dar EL-Shefa Hospital, 200 bed,(Renewal). Cairo, Egypt. With Shorpagy CO. Reporting To: Project Manager. Project Contractor: Shorpagy CO. Renewal of Dar El sheaf Hospital, which contains more than 200 bed, Scope of work was to Renew the building by adding Aluminum cladding to building Façade, and change all flooring to antibacterial types, and upgrade wall finish ( Stainless and Vinyl),with special care to different medical departments with various of specialized consultants. My Role in Hospital project: To Execute daily plan work and preparing shop drawing for consultant review and approval, and controlling daily site activities with project manager as following: -Preparing site construction detail and Supervising Execution on site. - Finalizing all technical issues for Intensive care unit with a specialized consultant. - Coordination with a medical requirement for finishes. - Hand over the project to hospital team. Site Engineer at (Office /warehouse building and stuff accommodation project) -a subcontractor for Schlumberger. Cairo, Shukeir, Egypt. With: Swanco oil service. Reporting To: Area Manager. Project Contractor: Swanco oil service. As one of top 3 Oil service companies in the world, Schlumberger decided to build workshop warehouse to maintain their drilling Equipment’s, include technical Engineers office within the warehouse, with high acoustic wall properties and specialist finishes material within warehouse area to comply with their requirement, also stuff accommodation building in Ras Shukeir (at western cost of Egypt) with 80 studio space capacity and including standard facilities ( Toilets-Central Kitchen- amusement space) and 60% of total area as landscape and hardscape . My Role in Office warehouse project: Working as construction manager for Office /warehouse building, Responsible for managing the construction process and ensure project plan with clients on a weekly basis. On the other hand I worked as freelance with Schlumberger to develop their stuff accommodation area in Shukeir area, developing the design and construction detail, and managing the construction process through subcontractors, so my responsibilities in Schlumberger projects was as following: -following daily project plan and manage daily work with subcontractors. -developing construction detail with consultant team on daily workshop. -preparing site daily/weekly report for client review. -managing long lead Items plan and highlighting risk on the project to the client. -preparing site inspections to consultant on a daily basis. -preparing monthly payment and submit it to the Consultant. -preparing close out documents. -perform handing over process to the client. Aug.2008 - Feb.2009 Aug.2007 – Aug 2008 Office warehouse building Cairo Egypt Start: 2007 Finish: 2008 Value: 15 m LE/ US$ 2.2m Owner: Schlumberger www.slb.com Site area: 2500m sq.m
  • 4.
    Mamdoh_attia@hotmail.comE_Mail:-Tel:+966562851319-Architect–Mamdouh attia 4 Market roadproject Luxor Egypt Start: 2004 Finish: 2006 Value: 23 m LE/ US$ 3m Owner: Ministry of defense http://el-shorbagy.com/ Site area: 3 k.m SCA projects Cairo/ Luxor / Alex. Egypt Start: 2006 Finish: 2007 Value: 120 m LE/ US$ 16m. Owner: SCA http://el-shorbagy.com/ SCA projects (supreme council of antiquities) As Technical Design Architect 1-Development of archaeological Al sawary pole area( management building + Lanscaping+monuments restoration) - Alexandria, Egypt. 2- Zoser Pyramid (restoration + Management office area) - Giza, Egypt. 3- Esna temple (restoration + Research to Model Original Temple). With: Shorpagy CO. Reporting To: Technical manager. Project Contractor: Shorpagy CO. Working as Technical Design Architect, for SCA projects, with Contracting company, mainly for three projects with Head office team, Designing and building the Landscape / hardscape, and design and built the office management area (ticket building /stuff building), supporting the Unesco team in restoration Research. My Role in SCA projects project: -Design management building and prepare presentation to consultant and clients. -draw and develop construction detail in detail design stage. -Preparing a monthly report about each project and make a presentation to clients. -supporting Unesco team in restoration research. -review monthly payments came from each site in head office. -perform monthly Technical Inspection with Technical manger to monitor Quality. -preparing close out documents. -perform handing over process to the client. july.2006 – Aug 2007 Site Technical Engineer Renewal and Development of Market road. Design and built project Luxor- Egypt. With: Shorpagy CO. Reporting To: Project Manager. Project Contractor: Shorpagy CO. This project one of Famous projects in Luxor city, Ministry of Defense decide to support development of Luxor city, Under Renewal and development of this city, Market Road area was developed by reestablishing the concept of Road design and unifying shop front elevation also adding setting area and cafe shop for the visitors and stamped concrete flooring with different patterns and providing semi-shaded space with historical Entrance gate reflects the value of history of the city. My Role in Marker Road project: Working as site Technical Architect to support design team to design setting area and hardscape and Entrance gate also arranging daily site work with subcontractors to reflect design concept to site as built condition, and presenting the construction detail to site team – detail responsibilities was as following: -participate design work and develop construction detail to meet as built condition. -preparing site daily/weekly report for client review. -preparing site inspections to the consultant on a daily basis. -preparing construction shop drawing and review with design team. -preparing close out documents. -perform handing over process to the client. April.2005 – July 2006
  • 5.
    Mamdoh_attia@hotmail.comE_Mail:-Tel:+966562851319-Architect–Mamdouh attia 5 KEY SKILLS -Sufficient knowledge in intelligent building solutions and drawing production. - Design talent corresponding with innovation. - Strong knowledge about Ironmongery and Doors Design and Fabrication. - Experience in designing security concept in office buildings. - Expertise in CAD administration and management - Quality Management in Project Execution as well as Project Design - Sustainable & Environmental Design Solutions - Commercial, Residential, Retail, Industrial, Administration, Education and Hospitality project experience. - Computer Aided Design skills; AutoCAD 2d, Sketch up3D, Adobe Photoshop & MS Project - Sufficient knowledge of IBC and NFPA-SBC-ANSI-ASTM Codes and Regulations - Good knowledge to solve Claims and Leading Design variation process during construction. International Experience:  Curtain walls design development and technical review for unitized cold pending system along with Smart blinds with International company’s such as (Permastlissa) – Italy ’’Venice’’ during 2012,2013.  Curtain wall Testing Preparation and Inspection for Unitized and stick system, with International Firms such as (Arup – japan) / (Nikken Sekki- Japan).  Tiling (Ceramic / Stone) factory and Material Inspection and selection process From A to Z (Italy – Spain),2014/2015.  Confirmation and Developing Elevator Caps design and Elevator/Escalators system, and confirmation of the factory and Mock-up preparation and selection in Switzerland (January-2015 / December 2016).  Custom glass material developing during Fabrication process with German Companies as (Interpan) during 2014.  Curtain Wall International seminars in Holland (Amsterdam) during 2014.  Aluminum Extrusion Profiles developing systems, and Inspecting Extrusion Factories, and Confirming Extrusion testing, (Athena Greece,2014).  Safety Design in Building Workshop conference, Fire protection and Evacuation Strategies – Dubai 2016. Reference Person: -Jan hencken (NIKKEN Senior Project Manager- Email: hencken.jan@nikken.jp -Brian Eshmade : MACE SR.Pr.Manager– E mail: Brian.Eshmade@macegroup.com -Wessam Ahmed:Diyar Resident Engineer –Email: Wesam.Ahmed@diyar.com. End Professional Affiliation - Member Arab council For Engineers. - Egyptians Council for Engineers - Saudi Council for Engineers Worked For
