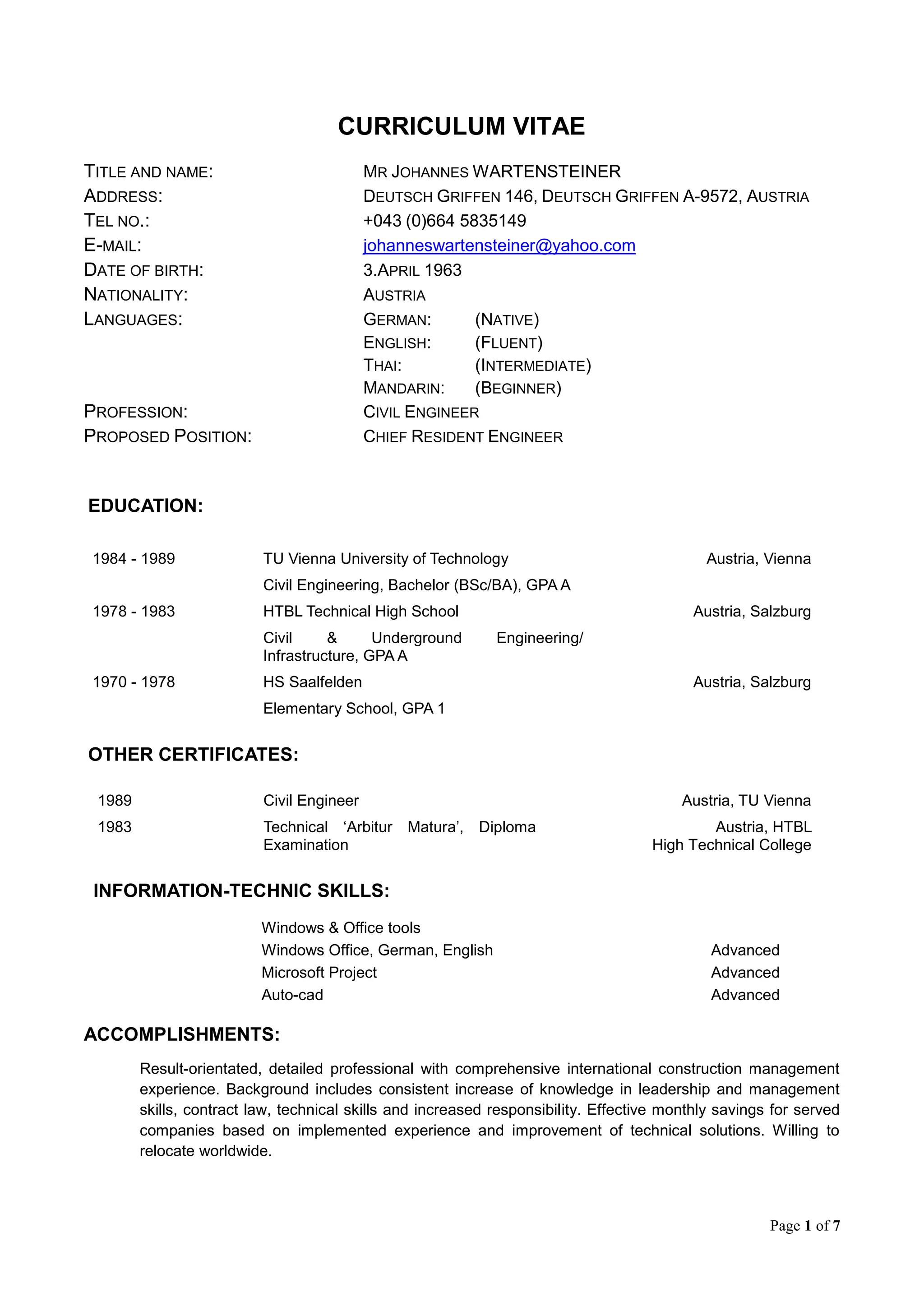

Page 1 of 7
CURRICULUM VITAE
TITLE AND NAME: MR JOHANNES WARTENSTEINER
ADDRESS: DEUTSCH GRIFFEN 146, DEUTSCH GRIFFEN A-9572, AUSTRIA
TEL NO.: +043 (0)664 5835149
E-MAIL: johanneswartensteiner@yahoo.com
DATE OF BIRTH: 3.APRIL 1963
NATIONALITY: AUSTRIA
LANGUAGES: GERMAN: (NATIVE)
ENGLISH: (FLUENT)
THAI: (INTERMEDIATE)
MANDARIN: (BEGINNER)
PROFESSION: CIVIL ENGINEER
PROPOSED POSITION: CHIEF RESIDENT ENGINEER
EDUCATION:
1984 - 1989 TU Vienna University of Technology Austria, Vienna
Civil Engineering, Bachelor (BSc/BA), GPA A
1978 - 1983 HTBL Technical High School Austria, Salzburg
Civil & Underground Engineering/
Infrastructure, GPA A
1970 - 1978 HS Saalfelden Austria, Salzburg
Elementary School, GPA 1
OTHER CERTIFICATES:
1989 Civil Engineer Austria, TU Vienna
1983 Technical ‘Arbitur Matura’, Diploma
Examination
Austria, HTBL
High Technical College
INFORMATION-TECHNIC SKILLS:
.
Windows & Office tools
Windows Office, German, English Advanced
Microsoft Project Advanced
Auto-cad Advanced
ACCOMPLISHMENTS:
Result-orientated, detailed professional with comprehensive international construction management
experience. Background includes consistent increase of knowledge in leadership and management
skills, contract law, technical skills and increased responsibility. Effective monthly savings for served
companies based on implemented experience and improvement of technical solutions. Willing to
relocate worldwide.

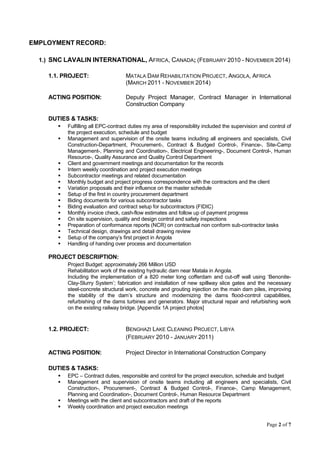

Page 2 of 7
EMPLOYMENT RECORD:
1.) SNC LAVALIN INTERNATIONAL, AFRICA, CANADA; (FEBRUARY 2010 - NOVEMBER 2014)
1.1. PROJECT: MATALA DAM REHABILITATION PROJECT, ANGOLA, AFRICA
(MARCH 2011 - NOVEMBER 2014)
ACTING POSITION: Deputy Project Manager, Contract Manager in International
Construction Company
DUTIES & TASKS:
 Fulfilling all EPC-contract duties my area of responsibility included the supervision and control of
the project execution, schedule and budget
 Management and supervision of the onsite teams including all engineers and specialists, Civil
Construction-Department, Procurement-, Contract & Budged Control-, Finance-, Site-Camp
Management-, Planning and Coordination-, Electrical Engineering-, Document Control-, Human
Resource-, Quality Assurance and Quality Control Department
 Client and government meetings and documentation for the records
 Intern weekly coordination and project execution meetings
 Subcontractor meetings and related documentation
 Monthly budget and project progress correspondence with the contractors and the client
 Variation proposals and their influence on the master schedule
 Setup of the first in country procurement department
 Biding documents for various subcontractor tasks
 Biding evaluation and contract setup for subcontractors (FIDIC)
 Monthly invoice check, cash-flow estimates and follow up of payment progress
 On site supervision, quality and design control and safety inspections
 Preparation of conformance reports (NCR) on contractual non conform sub-contractor tasks
 Technical design, drawings and detail drawing review
 Setup of the company’s first project in Angola
 Handling of handing over process and documentation
PROJECT DESCRIPTION:
Project Budget: approximately 266 Million USD
Rehabilitation work of the existing hydraulic dam near Matala in Angola.
Including the implementation of a 820 meter long cofferdam and cut-off wall using ‘Benonite-
Clay-Slurry System’; fabrication and installation of new spillway slice gates and the necessary
steel-concrete structural work, concrete and grouting injection on the main dam piles, improving
the stability of the dam’s structure and modernizing the dams flood-control capabilities,
refurbishing of the dams turbines and generators. Major structural repair and refurbishing work
on the existing railway bridge. [Appendix 1A project photos]
1.2. PROJECT: BENGHAZI LAKE CLEANING PROJECT, LIBYA
(FEBRUARY 2010 - JANUARY 2011)
ACTING POSITION: Project Director in International Construction Company
DUTIES & TASKS:
 EPC – Contract duties, responsible and control for the project execution, schedule and budget
 Management and supervision of onsite teams including all engineers and specialists, Civil
Construction-, Procurement-, Contract & Budged Control-, Finance-, Camp Management,
Planning and Coordination-, Document Control-, Human Resource Department
 Meetings with the client and subcontractors and draft of the reports
 Weekly coordination and project execution meetings
Page 3 of 7
 Monthly budget and progress reports for the client and the company headquarter office
 Drafting of the project correspondence with the contractors and the client
 Variation proposals and their influence on the project budget master schedules
 Biding documents and biding evaluation for various subcontractor tasks
 Contract drafts and contracting of subcontractors
 Monthly payment progress reports
 Advise on the buildup of the heavy machinery park including the implementation of proper
maintenance procedures
 Planning of manpower mobilization schedules to reach contractual milestone targets and the
documentation of the implemented manpower progress.
 Workout and drafting of budget proposals for variation orders on the project
PROJECT DESCRIPTION:
Project Budget: approximately 150 Million USD
Building of a modern green park and bird watching area near the Benghazi Lake in Libya.
Cleaning of the Benghazi Lake contaminated soil, including chemical treatment of the
excavated soil. Dredging and pumping of the contaminated slurry of the Benghazi harbor.
Treatment of contaminated soil in modern sludge treatment center. Landscaping and
infrastructure project in the lake area. Implementation of connection cannels between the open
sea and the lakes, construction of huge pumping stations to circulate the sea water and the
Benghazi Lake water volume. Construction of sewage system and the sewage treatment plant.
The construction of the project had to be stopped out of political reasons and civil war.
2.) SMEC INTERNATIONAL CONSULTANCY, QATAR; (JULY 2006 - DECEMBER 2009)
ACTING POSITION: Resident Engineer, Civil Engineer in International Consultancy
Company
PROJECT: WASTE TO ENERGY CENTER INCLUDING 52 MW STEAM POWER
PLANT, QATAR
Client: Qatar Government Ministry for Municipality and Urban
Planning
DUTIES & TASKS:
 Consultancy Duties, representation of the clients rights on the project.
 Weekly client meetings and preparation of the Minutes of Meetings Documents.
 Assistance and documentation on all implemented site activities of the EPC-contractor on the
project
 Implementation of appropriate systems for document handling and working progress monitoring.
 Preparation of correspondence and coordination with project engineers for submission to the
client
 Budged control, including handling of variation orders and professional advice to the client.
 Advice to the Client on the FIDIC contractual and contract law issues during the execution of the
project
 Correspondence drafts regarding all disputes and non-conformance reports.
 Advise of the client regarding project material selection and material approval reports
 Preparation and submissions of non-conformance reports NCR’s
 Assistance of the client during additional claims, variation orders and client contractor and client
sub-contractor meetings
 Onsite inspections and reports on suitable safety measures during on site construction work and
erection activities
 Project commissioning and ultimate handover procedure support
 Site safety inspections and safety reports
 Participation in overall supervision of civil construction, site erection works and reports regarding
the compliance with the drawings and technical specifications of the project design.
 Check up on the contractor erection procedures reports, statements and advice to the client
 Project reports for the client and the Qatar government
Page 4 of 7
 Client advice and reports regarding the overall compliance of the EPC-contractor project work
with the contractual conditions.
 Project on site team management including motivation guidance of 21 professionals [structural-,
mechanical-, electrical-, process senior engineers and engineers, quantity survey, quality
assurance and quality control, planning and coordination coordinator engineer, document
controller and secretary]
 Assistance of the client during the commissioning procedure, test and support regarding the
handover documents, records and certificates
 Guidance and advice to the client regarding maintenance procedure set ups and implemented
maintenance schedules by the contractors and equipment suppliers
PROJECT DESCRIPTION:
Project Budget: approximately 1.2 Billion USD
*) Attachment 1A: Site Progress Photos
Waste to Energy Plant (52 MW Steam Turbine) in Qatar, concrete - pre- and post- stressed
concrete structure combined with large steel structure, budget:, site area – 4.2 x 2.1 km, state
of art, huge dimension site, capacity of temporary worker accommodation 2000 persons,
temporary site connection road 6 km, fencing 12 km, construction time 36 month.
Client: Qatar Government Ministry for Municipality and Urban Planning.
Project areas and structures: transfer stations, 4 x incinerators, burners, compost plant, steam
power generation plant 52 MW, ash treatment plant, landfills, bulky waste storage area,
“Danno” Drums by Keppler-Seghers Singapore, recycling hall, waste bunkers, waste water
treatment plant, chimney 90 m in slip-form construction, evaporator structure, tank areas,
fertilizer building, weigh bridges, construction waste and demolition waste structures,
infrastructure work including concrete roads, staff accommodation area, recreation area.
3.) UHDE/ THYSSEN/ KRUP, GERMANY (MARCH 2005 - MAI 2006)
ACTING POSITION: Senior Civil Engineer in International Consultancy Company
PROJECT: INDUSTRIAL FUMED SILICA PLANT, CHINA
DUTIES & TASKS:
 Consultancy Duties, representation of the clients rights on the project.
 Management and supervision of onsite teams including all engineers and specialists of the civil
construction department
 Weekly construction meetings and preparation of the minutes of meetings documentation.
 Onsite inspections and reports on suitable safety measures during on site construction work and
erection activities
 Check up on the contractor erection procedures reports, statements and advice to the client.
 Subcontractor meetings and necessary documentation.
 Documentation and preparation of daily, weekly and monthly civil structure work progress reports
 Preparation of non conformance reports (NCR’s).
 Design, structural and detail drawing checks on mistakes and technical aspects.
 Budged control, including handling of variation orders and professional advice to project manager
 Biding documents for various subcontractor tasks
 Safety inspections and safety reports
 Statement reports regarding construction material, supply change and material approvals.
 Check up and advice reports to the project manager regarding civil work schedule erection
schedule and manpower mobilization reports submitted by the contractors
 Attendance during client consultancy meetings and professional advice regarding all civil
structural work execution on site to the client.
 Assistance of the client during additional claims, variation orders and client contractor and client
sub-contractor meetings.
 Participation in overall supervision of civil construction, site erection works and reports regarding
the compliance with the drawings and technical specifications of the project design.
Page 5 of 7

PROJECT DESCRIPTION:
Project Budget: approximately 132 Million USD
Industrial Project Fumed Silica Plant.
Site areas and production and storage structures: infrastructure buildings, roads, fabrication
plant, final storage hall, silo storage, 2 x 80.000 liter oil tanks, 7400 m2 of management
offices facilities, 32 pipe racks, foundation work and concrete ram-piling, 32 km of high
pressure piping, drainage piping, all construction of the fabrication halls and roofed storage
areas in high quality steel and reinforced concrete. Erection and installation of heavy steel
prefabricated equipment for the silica process plant.
4.) METRO CASH & CARRY, CHINA, VIETNAM, GERMANY; (MAI 2000 - FEBRUARY 2005)
ACTING POSITION: Senior Project Manager for the Owner
PROJECT: RETAIL- & HYPERMARKET PROJECTS, CHINA, VIETNAM
DUTIES & TASKS:
 Duties, representation of the owners rights on the project.
 Contracting and evaluation of design-and architecture offices in local project cities.
 Management built up and supervision of onsite teams including all engineers and specialists of
the civil construction department, logistic and mechanical department. (team size of 16 engineers
and specialists and secretary)
 Tender documents, tender evaluation and contracting of sub-contractors for the project.
 Onsite inspections and reports on suitable safety measures during on site construction work and
erection activities
 Check up on the contractor erection procedures reports, statements and advice to the company
CEO’s. (Country Manager)
 Subcontractor meetings and necessary documentation
 Documentation and preparation of daily, weekly and monthly budget, schedule, progress reports
to the company CO’s and Shareholders
 Supervision of the site engineers and specialists of the mechanical- and electrical works.
 Design, structural and detail drawing checks on mistakes and technical aspects and evaluation of
their influence on the master budget
 Directed and prepared project schedules in cooperation with the contractors and sub-contractors
and the companies country management
 Bid preparation and biding documents for various subcontractor tasks
 Shareholder meetings, support and advice in onsite tours and the necessary documentation.
 Statement reports regarding construction material change, and material approvals
 Overall supervision of civil construction, site erection works and reports regarding the compliance
with the drawings and technical specifications of the project design.
 Preparation of monthly CEO and Shareholder project reports
 Scheduling of Import procedures regarding all heavy equipment from over-sea. [high-racks,
fittings, advertisement letters]
 Final hand-over documentation and reports
PROJECT DESCRIPTION:
Project Budget: per Hypermarket approximately 45 Million USD
Project Locations -
China: Retail- & Hypermarket Projects in Shanghai, Fuzhou, Nanjing, Hangzhou, Qingdao,
Zhangjiagang, Chengdu.
Vietnam: Retail- & Hypermarket Projects in Ho Chi Minh 1, Ho Chi Minh 2, Hanoi.
Piling, steel- reinforced concrete structure, sales area 14.000 m2, office and administration
4.000 m2, deep freezer structures, sea water tanks, sewage treatment plant, grease traps,
advertisement towers, fittings, high raking, concrete water tanks, transformer stations, special
joint-free industrial floor technology, parking area, diesel tanks, security system.
Page 6 of 7
5.) HOFMAN & MACULAN, AUSTRIA; (FEBRUARY 1993 - MARCH 2000)
ACTING POSITION: Civil Engineer in Construction Company
PROJECT: INFRASTRUCTURE, SEWAGE SYSTEM AND SEWAGE TREATMENT
PLANT, SALZBURG, AUSTRIA
DUTIES & TASKS:
 Duties included all EPC contractor duties on site
 Onsite coordination meetings and minutes of meetings documentation
 Control of site coordination, procurement, logistic and material supply to sites
 Preparation of daily reports, weekly reports and monthly progress reports
 Budget Control and documentation
 Variation Proposals for the Consultancy and the client project manager
 Manpower mobilization in coordination with the human resource department of the company
 Check of design and detail design drawings and statement reports for the Architect and Planer
 Preparation of technical detail drawings and technical solutions for daily on site tasks
 Control of the project design, quality, schedules and their cost estimates
 Monthly progress reports, budget reports in comparison to the project estimates
PROJECT DESCRIPTION:
Project Budget: approximately 340 Million USD
Infrastructure Project Salzburg/South - Anif
sewage system including sewage treatment plant, pump stations, inverted siphon, separation
tanks, energy vitiation structures, high pressure piping, grease trap structures, pipe
dimensions 250 mm to 2800 mm.
6.) SINGLE DESIGN & CONSTRUCTION, AUSTRIA; (OCTOBER 1986 - DECEMBER1992)
ACTING POSITION: Country Manager in Design-and Consultancy Company
PROJECT: VARIOUS INDUSTRIAL AND HOUSING PROJECTS IN VIENNA,
AUSTRIA
DUTIES & TASKS:
 Consultancy Duties, representation of the clients rights on the project.
 Establishments of annual business plans.
 Setting up of business strategies and business objectives.
 Control of site coordination, procurement, logistic and material supply to sites.
 Control and supervision of all professionals in the Design Department, Engineering Department,
Personal Department, Procurement Department, Site Management Department, Contract
Department and Secretary
 Budget Control and Documentation.
 Design Proposals and Budged Proposals for the Client.
 Client Meetings and Documentation.
PROJECT DESCRIPTION:
Project Budget: summary approximately 50 Million USD
Various Turn Key- Industrial and Housing Projects in Vienna
Page 7 of 7
ATTACHMENT:
PHOTO APPLICANT
JOHANNES WARTENSTEINER
27.05.2015
CIVIL ENGINEER
A U S T R I A

CURRICULUM VITAE World Bank Format V3

  • 1.
    Page 1 of7 CURRICULUM VITAE TITLE AND NAME: MR JOHANNES WARTENSTEINER ADDRESS: DEUTSCH GRIFFEN 146, DEUTSCH GRIFFEN A-9572, AUSTRIA TEL NO.: +043 (0)664 5835149 E-MAIL: johanneswartensteiner@yahoo.com DATE OF BIRTH: 3.APRIL 1963 NATIONALITY: AUSTRIA LANGUAGES: GERMAN: (NATIVE) ENGLISH: (FLUENT) THAI: (INTERMEDIATE) MANDARIN: (BEGINNER) PROFESSION: CIVIL ENGINEER PROPOSED POSITION: CHIEF RESIDENT ENGINEER EDUCATION: 1984 - 1989 TU Vienna University of Technology Austria, Vienna Civil Engineering, Bachelor (BSc/BA), GPA A 1978 - 1983 HTBL Technical High School Austria, Salzburg Civil & Underground Engineering/ Infrastructure, GPA A 1970 - 1978 HS Saalfelden Austria, Salzburg Elementary School, GPA 1 OTHER CERTIFICATES: 1989 Civil Engineer Austria, TU Vienna 1983 Technical ‘Arbitur Matura’, Diploma Examination Austria, HTBL High Technical College INFORMATION-TECHNIC SKILLS: . Windows & Office tools Windows Office, German, English Advanced Microsoft Project Advanced Auto-cad Advanced ACCOMPLISHMENTS: Result-orientated, detailed professional with comprehensive international construction management experience. Background includes consistent increase of knowledge in leadership and management skills, contract law, technical skills and increased responsibility. Effective monthly savings for served companies based on implemented experience and improvement of technical solutions. Willing to relocate worldwide.
  • 2.
    Page 2 of7 EMPLOYMENT RECORD: 1.) SNC LAVALIN INTERNATIONAL, AFRICA, CANADA; (FEBRUARY 2010 - NOVEMBER 2014) 1.1. PROJECT: MATALA DAM REHABILITATION PROJECT, ANGOLA, AFRICA (MARCH 2011 - NOVEMBER 2014) ACTING POSITION: Deputy Project Manager, Contract Manager in International Construction Company DUTIES & TASKS:  Fulfilling all EPC-contract duties my area of responsibility included the supervision and control of the project execution, schedule and budget  Management and supervision of the onsite teams including all engineers and specialists, Civil Construction-Department, Procurement-, Contract & Budged Control-, Finance-, Site-Camp Management-, Planning and Coordination-, Electrical Engineering-, Document Control-, Human Resource-, Quality Assurance and Quality Control Department  Client and government meetings and documentation for the records  Intern weekly coordination and project execution meetings  Subcontractor meetings and related documentation  Monthly budget and project progress correspondence with the contractors and the client  Variation proposals and their influence on the master schedule  Setup of the first in country procurement department  Biding documents for various subcontractor tasks  Biding evaluation and contract setup for subcontractors (FIDIC)  Monthly invoice check, cash-flow estimates and follow up of payment progress  On site supervision, quality and design control and safety inspections  Preparation of conformance reports (NCR) on contractual non conform sub-contractor tasks  Technical design, drawings and detail drawing review  Setup of the company’s first project in Angola  Handling of handing over process and documentation PROJECT DESCRIPTION: Project Budget: approximately 266 Million USD Rehabilitation work of the existing hydraulic dam near Matala in Angola. Including the implementation of a 820 meter long cofferdam and cut-off wall using ‘Benonite- Clay-Slurry System’; fabrication and installation of new spillway slice gates and the necessary steel-concrete structural work, concrete and grouting injection on the main dam piles, improving the stability of the dam’s structure and modernizing the dams flood-control capabilities, refurbishing of the dams turbines and generators. Major structural repair and refurbishing work on the existing railway bridge. [Appendix 1A project photos] 1.2. PROJECT: BENGHAZI LAKE CLEANING PROJECT, LIBYA (FEBRUARY 2010 - JANUARY 2011) ACTING POSITION: Project Director in International Construction Company DUTIES & TASKS:  EPC – Contract duties, responsible and control for the project execution, schedule and budget  Management and supervision of onsite teams including all engineers and specialists, Civil Construction-, Procurement-, Contract & Budged Control-, Finance-, Camp Management, Planning and Coordination-, Document Control-, Human Resource Department  Meetings with the client and subcontractors and draft of the reports  Weekly coordination and project execution meetings
  • 3.
    Page 3 of7  Monthly budget and progress reports for the client and the company headquarter office  Drafting of the project correspondence with the contractors and the client  Variation proposals and their influence on the project budget master schedules  Biding documents and biding evaluation for various subcontractor tasks  Contract drafts and contracting of subcontractors  Monthly payment progress reports  Advise on the buildup of the heavy machinery park including the implementation of proper maintenance procedures  Planning of manpower mobilization schedules to reach contractual milestone targets and the documentation of the implemented manpower progress.  Workout and drafting of budget proposals for variation orders on the project PROJECT DESCRIPTION: Project Budget: approximately 150 Million USD Building of a modern green park and bird watching area near the Benghazi Lake in Libya. Cleaning of the Benghazi Lake contaminated soil, including chemical treatment of the excavated soil. Dredging and pumping of the contaminated slurry of the Benghazi harbor. Treatment of contaminated soil in modern sludge treatment center. Landscaping and infrastructure project in the lake area. Implementation of connection cannels between the open sea and the lakes, construction of huge pumping stations to circulate the sea water and the Benghazi Lake water volume. Construction of sewage system and the sewage treatment plant. The construction of the project had to be stopped out of political reasons and civil war. 2.) SMEC INTERNATIONAL CONSULTANCY, QATAR; (JULY 2006 - DECEMBER 2009) ACTING POSITION: Resident Engineer, Civil Engineer in International Consultancy Company PROJECT: WASTE TO ENERGY CENTER INCLUDING 52 MW STEAM POWER PLANT, QATAR Client: Qatar Government Ministry for Municipality and Urban Planning DUTIES & TASKS:  Consultancy Duties, representation of the clients rights on the project.  Weekly client meetings and preparation of the Minutes of Meetings Documents.  Assistance and documentation on all implemented site activities of the EPC-contractor on the project  Implementation of appropriate systems for document handling and working progress monitoring.  Preparation of correspondence and coordination with project engineers for submission to the client  Budged control, including handling of variation orders and professional advice to the client.  Advice to the Client on the FIDIC contractual and contract law issues during the execution of the project  Correspondence drafts regarding all disputes and non-conformance reports.  Advise of the client regarding project material selection and material approval reports  Preparation and submissions of non-conformance reports NCR’s  Assistance of the client during additional claims, variation orders and client contractor and client sub-contractor meetings  Onsite inspections and reports on suitable safety measures during on site construction work and erection activities  Project commissioning and ultimate handover procedure support  Site safety inspections and safety reports  Participation in overall supervision of civil construction, site erection works and reports regarding the compliance with the drawings and technical specifications of the project design.  Check up on the contractor erection procedures reports, statements and advice to the client  Project reports for the client and the Qatar government
  • 4.
    Page 4 of7  Client advice and reports regarding the overall compliance of the EPC-contractor project work with the contractual conditions.  Project on site team management including motivation guidance of 21 professionals [structural-, mechanical-, electrical-, process senior engineers and engineers, quantity survey, quality assurance and quality control, planning and coordination coordinator engineer, document controller and secretary]  Assistance of the client during the commissioning procedure, test and support regarding the handover documents, records and certificates  Guidance and advice to the client regarding maintenance procedure set ups and implemented maintenance schedules by the contractors and equipment suppliers PROJECT DESCRIPTION: Project Budget: approximately 1.2 Billion USD *) Attachment 1A: Site Progress Photos Waste to Energy Plant (52 MW Steam Turbine) in Qatar, concrete - pre- and post- stressed concrete structure combined with large steel structure, budget:, site area – 4.2 x 2.1 km, state of art, huge dimension site, capacity of temporary worker accommodation 2000 persons, temporary site connection road 6 km, fencing 12 km, construction time 36 month. Client: Qatar Government Ministry for Municipality and Urban Planning. Project areas and structures: transfer stations, 4 x incinerators, burners, compost plant, steam power generation plant 52 MW, ash treatment plant, landfills, bulky waste storage area, “Danno” Drums by Keppler-Seghers Singapore, recycling hall, waste bunkers, waste water treatment plant, chimney 90 m in slip-form construction, evaporator structure, tank areas, fertilizer building, weigh bridges, construction waste and demolition waste structures, infrastructure work including concrete roads, staff accommodation area, recreation area. 3.) UHDE/ THYSSEN/ KRUP, GERMANY (MARCH 2005 - MAI 2006) ACTING POSITION: Senior Civil Engineer in International Consultancy Company PROJECT: INDUSTRIAL FUMED SILICA PLANT, CHINA DUTIES & TASKS:  Consultancy Duties, representation of the clients rights on the project.  Management and supervision of onsite teams including all engineers and specialists of the civil construction department  Weekly construction meetings and preparation of the minutes of meetings documentation.  Onsite inspections and reports on suitable safety measures during on site construction work and erection activities  Check up on the contractor erection procedures reports, statements and advice to the client.  Subcontractor meetings and necessary documentation.  Documentation and preparation of daily, weekly and monthly civil structure work progress reports  Preparation of non conformance reports (NCR’s).  Design, structural and detail drawing checks on mistakes and technical aspects.  Budged control, including handling of variation orders and professional advice to project manager  Biding documents for various subcontractor tasks  Safety inspections and safety reports  Statement reports regarding construction material, supply change and material approvals.  Check up and advice reports to the project manager regarding civil work schedule erection schedule and manpower mobilization reports submitted by the contractors  Attendance during client consultancy meetings and professional advice regarding all civil structural work execution on site to the client.  Assistance of the client during additional claims, variation orders and client contractor and client sub-contractor meetings.  Participation in overall supervision of civil construction, site erection works and reports regarding the compliance with the drawings and technical specifications of the project design.
  • 5.
    Page 5 of7 PROJECT DESCRIPTION: Project Budget: approximately 132 Million USD Industrial Project Fumed Silica Plant. Site areas and production and storage structures: infrastructure buildings, roads, fabrication plant, final storage hall, silo storage, 2 x 80.000 liter oil tanks, 7400 m2 of management offices facilities, 32 pipe racks, foundation work and concrete ram-piling, 32 km of high pressure piping, drainage piping, all construction of the fabrication halls and roofed storage areas in high quality steel and reinforced concrete. Erection and installation of heavy steel prefabricated equipment for the silica process plant. 4.) METRO CASH & CARRY, CHINA, VIETNAM, GERMANY; (MAI 2000 - FEBRUARY 2005) ACTING POSITION: Senior Project Manager for the Owner PROJECT: RETAIL- & HYPERMARKET PROJECTS, CHINA, VIETNAM DUTIES & TASKS:  Duties, representation of the owners rights on the project.  Contracting and evaluation of design-and architecture offices in local project cities.  Management built up and supervision of onsite teams including all engineers and specialists of the civil construction department, logistic and mechanical department. (team size of 16 engineers and specialists and secretary)  Tender documents, tender evaluation and contracting of sub-contractors for the project.  Onsite inspections and reports on suitable safety measures during on site construction work and erection activities  Check up on the contractor erection procedures reports, statements and advice to the company CEO’s. (Country Manager)  Subcontractor meetings and necessary documentation  Documentation and preparation of daily, weekly and monthly budget, schedule, progress reports to the company CO’s and Shareholders  Supervision of the site engineers and specialists of the mechanical- and electrical works.  Design, structural and detail drawing checks on mistakes and technical aspects and evaluation of their influence on the master budget  Directed and prepared project schedules in cooperation with the contractors and sub-contractors and the companies country management  Bid preparation and biding documents for various subcontractor tasks  Shareholder meetings, support and advice in onsite tours and the necessary documentation.  Statement reports regarding construction material change, and material approvals  Overall supervision of civil construction, site erection works and reports regarding the compliance with the drawings and technical specifications of the project design.  Preparation of monthly CEO and Shareholder project reports  Scheduling of Import procedures regarding all heavy equipment from over-sea. [high-racks, fittings, advertisement letters]  Final hand-over documentation and reports PROJECT DESCRIPTION: Project Budget: per Hypermarket approximately 45 Million USD Project Locations - China: Retail- & Hypermarket Projects in Shanghai, Fuzhou, Nanjing, Hangzhou, Qingdao, Zhangjiagang, Chengdu. Vietnam: Retail- & Hypermarket Projects in Ho Chi Minh 1, Ho Chi Minh 2, Hanoi. Piling, steel- reinforced concrete structure, sales area 14.000 m2, office and administration 4.000 m2, deep freezer structures, sea water tanks, sewage treatment plant, grease traps, advertisement towers, fittings, high raking, concrete water tanks, transformer stations, special joint-free industrial floor technology, parking area, diesel tanks, security system.
  • 6.
    Page 6 of7 5.) HOFMAN & MACULAN, AUSTRIA; (FEBRUARY 1993 - MARCH 2000) ACTING POSITION: Civil Engineer in Construction Company PROJECT: INFRASTRUCTURE, SEWAGE SYSTEM AND SEWAGE TREATMENT PLANT, SALZBURG, AUSTRIA DUTIES & TASKS:  Duties included all EPC contractor duties on site  Onsite coordination meetings and minutes of meetings documentation  Control of site coordination, procurement, logistic and material supply to sites  Preparation of daily reports, weekly reports and monthly progress reports  Budget Control and documentation  Variation Proposals for the Consultancy and the client project manager  Manpower mobilization in coordination with the human resource department of the company  Check of design and detail design drawings and statement reports for the Architect and Planer  Preparation of technical detail drawings and technical solutions for daily on site tasks  Control of the project design, quality, schedules and their cost estimates  Monthly progress reports, budget reports in comparison to the project estimates PROJECT DESCRIPTION: Project Budget: approximately 340 Million USD Infrastructure Project Salzburg/South - Anif sewage system including sewage treatment plant, pump stations, inverted siphon, separation tanks, energy vitiation structures, high pressure piping, grease trap structures, pipe dimensions 250 mm to 2800 mm. 6.) SINGLE DESIGN & CONSTRUCTION, AUSTRIA; (OCTOBER 1986 - DECEMBER1992) ACTING POSITION: Country Manager in Design-and Consultancy Company PROJECT: VARIOUS INDUSTRIAL AND HOUSING PROJECTS IN VIENNA, AUSTRIA DUTIES & TASKS:  Consultancy Duties, representation of the clients rights on the project.  Establishments of annual business plans.  Setting up of business strategies and business objectives.  Control of site coordination, procurement, logistic and material supply to sites.  Control and supervision of all professionals in the Design Department, Engineering Department, Personal Department, Procurement Department, Site Management Department, Contract Department and Secretary  Budget Control and Documentation.  Design Proposals and Budged Proposals for the Client.  Client Meetings and Documentation. PROJECT DESCRIPTION: Project Budget: summary approximately 50 Million USD Various Turn Key- Industrial and Housing Projects in Vienna
  • 7.
    Page 7 of7 ATTACHMENT: PHOTO APPLICANT JOHANNES WARTENSTEINER 27.05.2015 CIVIL ENGINEER A U S T R I A
