Case Study Texas A&M: A Strategic
Approach to Your Deferral Rate
         Presented by: David Kadamus, President & CEO - Sightlines

                                                                     1
Impact of Scrubbing and Adding Projects
Original $1.6 billion FCA inventory scrubbed to $720 million

                                                             The Scrubbing Process:
                                                               • Segregated very large projects into
Descriptive text goes here                                       repairs, component replacement or full
          $1.7
                                                                 system upgrade.
                   $1.5                                        • Reassessing project timeframes
                                                               • Separated E&G from Auxiliary projects
                                                               • Interviews with the facility managers
                   $1.3
                                                                 and selected Deans to reconcile major
      $ Billions

                                                                 building needs with program directions.
                   $1.1

                   $0.9
                                                                                Baseline
                                                                                           $0.720
                   $0.7

                   $0.5
                          Beginning FCA       Scrubbed Out            New Projects   Current 10 Year
                            Inventory            Projects               Added          Inventory

     Scrubbed Out projects included projects beyond 10 years and auxiliaries

                                                                                                           2
                                                                                                           2

Summary of the E&G project inventory
Projects by Category

      The Total $720 Million Need by Timeframe
Descriptive text goes here

                                 C (8 to 10
                                Yrs.), $167 ,
             B (4 to 7 Yrs.),       23%
              $364 , 51%

                                A (0 to 3 Yrs.),
                                 $189 , 26%

       All Projects were codified by:
            • Timeframe
            • Capital Investment Category
            • Investment Criteria
            • Building Portfolio

                                                   3
                                                   3

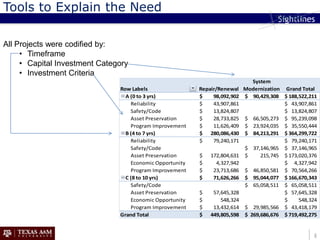

Tools to Explain the Need

All Projects were codified by:
     • Timeframe
Descriptive text goes here
     • Capital Investment Category
     • Investment Criteria
                                                                             System
                               Row Labels                 Repair/Renewal Modernization Grand Total
                                 A (0 to 3 yrs)           $    98,092,902 $ 90,429,308 $ 188,522,211
                                   Reliability            $    43,907,861               $ 43,907,861
                                   Safety/Code            $    13,824,807               $ 13,824,807
                                   Asset Preservation     $    28,733,825 $ 66,505,273 $ 95,239,098
                                   Program Improvement    $    11,626,409 $ 23,924,035 $ 35,550,444
                                 B (4 to 7 yrs)           $ 280,086,430 $ 84,213,291 $ 364,299,722
                                   Reliability            $    79,240,171               $ 79,240,171
                                   Safety/Code                             $ 37,146,965 $ 37,146,965
                                   Asset Preservation     $ 172,804,631 $       215,745 $ 173,020,376
                                   Economic Opportunity   $      4,327,942              $ 4,327,942
                                   Program Improvement    $    23,713,686 $ 46,850,581 $ 70,564,266
                                 C (8 to 10 yrs)          $    71,626,266 $ 95,044,077 $ 166,670,343
                                   Safety/Code                             $ 65,058,511 $ 65,058,511
                                   Asset Preservation     $    57,645,328               $ 57,645,328
                                   Economic Opportunity   $        548,324              $     548,324
                                   Program Improvement    $    13,432,614 $ 29,985,566 $ 43,418,179
                               Grand Total                $ 449,805,598 $ 269,686,676 $ 719,492,275

                                                                                                   4
                                                                                                   4

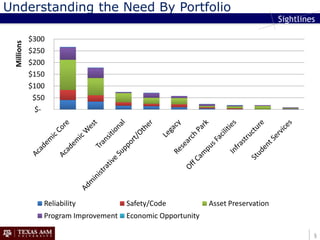

Understanding the Need By Portfolio

       $300
   Millions

       $250
Descriptive text goes here
       $200
       $150
       $100
        $50
         $-

              Reliability           Safety/Code            Asset Preservation
              Program Improvement   Economic Opportunity

                                                                                5
                                                                                5

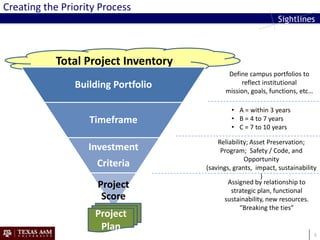

Creating the Priority Process

           Total Project Inventory
                                             Define campus portfolios to
                Building Portfolio               reflect institutional
                                            mission, goals, functions, etc…

                                              • A = within 3 years
                   Timeframe                  • B = 4 to 7 years
                                              • C = 7 to 10 years

                                         Reliability; Asset Preservation;
                   Investment             Program; Safety / Code, and
                                                   Opportunity
                     Criteria        (savings, grants, impact, sustainability
                                                         )
                     Project                 Assigned by relationship to
                                              strategic plan, functional
                      Score                sustainability, new resources.
                                                 “Breaking the ties”
                    Project
                     Plan
                                                                              6

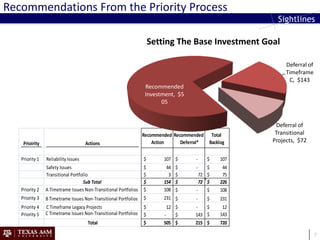

Recommendations From the Priority Process

                                                                     Setting The Base Investment Goal

                                                                                                            Deferral of
                                                                                                            Timeframe
                                                                                                             C, $143
                                                                  Recommended
                                                                  Investment, $5
                                                                        05

                                                                                                        Deferral of
                                                                 Recommended Recommended     Total      Transitional
    Prioirity                        Actions                         Action     Deferral*   Backlog    Projects, $72

   Priority 1   Reliability Issues                               $       107 $        -     $    107
                Safety Issues                                    $        44   $      -    $      44
                Transitional Portfolio                           $         3   $        72 $      75
                                   Sub Total                     $       154   $        72 $     226
   Priority 2   A Timetrame Issues Non-Transitional Portfolios   $       108   $      -    $     108
   Priority 3   B Timetrame Issues Non-Transitional Portfolios   $       231 $        -     $    231
   Priority 4   C Timeframe Legacy Projects                      $         12 $      -   $        12
   Priority 5   C Timetrame Issues Non-Transitional Portfolios   $       -    $      143 $       143
                                      Total                      $       505 $       215 $       720

                                                                                                                          7
Summary of Recommended Funding Plan

                                      8
Contact us:
