Why do youneed a BPM model?
Your processes are your way of doing business and often time is
the most neglected part of the business. Done the right way they
are the key to simplicity, scalability, efficiency, and profitability.
• Are your processes documented the way you want them
done?
• Does each employee know the process they are following
and why?
• Do they complete them accurately?
• Do errors and rework keep you up at night or
• Or cause you to spend time working in the business?
4.
A Sharper Approachto Business Process
Performance
Standards
Document
Main Processes
Process Maps
Stoplight Report
Leadership Team
WIN Meetings
Accountability in ASANA
Why Process Mapping?
•It ensures that your organization does the Process the same
way every time
• Improve Employee Productivity
• It identifies steps that are not needed in the process
• Removes steps created by the thinking that “we’ve always
done it that way”
• It helps create checklists for each department
• It helps identified where you can apply technology to
streamline and automate the process
• It allows you to work on the business and not in the business.
Create a self-sustaining business
• I believe in the 20/80 rule when documenting processes.
Identify your main processes and document them.
• By documenting your main processes it give you peace of mind
knowing that everything is done the way you want it
consistently and proficiently.
7.

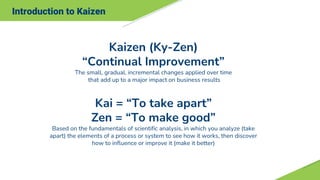

Introduction to Kaizen
Kaizen(Ky-Zen)
“Continual Improvement”
The small, gradual, incremental changes applied over time
that add up to a major impact on business results
Kai = “To take apart”
Zen = “To make good”
Based on the fundamentals of scientific analysis, in which you analyze (take
apart) the elements of a process or system to see how it works, then discover
how to influence or improve it (make it better)
Ten Basic Principlesfor Improvement
1. Throw out all fixed ideas about how to do things.
2. Think of how the new method WILL work-not how it
won’t.
3. Don’t accept excuses…Totally deny the status quo.
4. Don’t seek perfection on the first pass, build improvement.
5. Correct mistakes the moment they are found.
6. Don’t spend a lot of money on improvements.
7. Problems give you a chance to use your brain!
8. Ask “Why” at least five times until you find root cause.
9. Ten peoples ideas are better than that of one person.
10.Improvement knows NO limits!!
Process Map
2 Categoriesof Process Maps:
Ø“As Is”
• To truly understand how a process works in the real world
• Continuous improvement
• Lean the process
• Problem identification
• Eliminate wait time, rework, and other non-value added time
Ø“Should Be”
• To Establish performance standards
• To Establish standard processes
• To Establish process expectations
• Training
• Customer expectations
12.

Functional Deployment Map
1.Identify the participants of the process
from start-to-top point. Place the
customer at the upper left corner.
2. Identify the “trigger” or initial step and
identify the “final” step
3. Identify what step receives the output
of the initial step and what activity
they perform
4. Repeat by identifying what receives
the output from the second step and
what activity they perform
5. Continue identifying steps and align
vertically with participants
13.
Standard Symbols forProcess Maps
Start & End Points Identify the boundaries of the process.
Activity What is being done. Indicates necessary and unnecessary
activities performed in the process.
Decision Illustrates decision points and where loops occur in the process.
Also used to accept, reject, approve, etc.
Arrow Represents a process path/flow
Predefined Process This is a process identified within the process or a sub process.
Sample “As Is”Process Map
Fix and flip
property is
identified
Gain access
Create sow and end
date
Get bids of windows,
roof and foundation
Decide on contractors
and General
Close on property
Get bids HVAC
Decide on HVAC
contractor: Is
there a storage for
supplies?
Order supplies using
from Home Depot
Coordinate delivery of
materials
General contractor
check materials in and
secures them
Give general contractor
money 1st draw.
Some subs get worked
with directly.
Twice Weekly check
contractors status and
SOW
Is changed to
SOW Needed?
Contractor does work in
order of importance
predefined by GM
Payment schedule is based
SOW decided upon Visual
inspection and comparison
to the SOW. Payment are
in three schedules
Work is complete
Final payment is made
after visual inspection
Order a photographer Realtor list property
Property is
ready for
Marketing
No
No
Revise
Order Pod
Sales
Manager
Yes
Yes
Waste Types Defined
“Therelentless pursuit of the
elimination of waste from every
business process…”
The Objective of Lean
1
2
3
4
5
6
7
8 Behavioral
Defects
Inventory
Waiting
Over Processing
Over Production
Transportation
Motion
Type of Waste Definition
Excessive movement by people or
machines
Product moving from person to
person or between locations
Producing more than is required at
the current time
Unnecessary work beyond what is
needed to meet customer
requirements
Periods of inactivity while waiting for
the next process step to begin
Unprocessed or partially processed
materials, or undelivered finished
goods
Process steps that result in scrap,
rework or re-processing
Unused creativity and underutilized
human capital
SALES
P.C.
ADMIN
Finance
Vendor
FIX AND FLIP"SHOULD BE"
Fix and Flip
contract is
signed for
purchase
Task is created
via podio for
inspection &
SOW
Update
information
into Podio
Get SOW
completed &
create
materials list
Podio sends
email to
Vendor for
inspection
inspection
process
Was inspection
completed
No
Did it pass? Yes
No
Notify
Integrator and
Renegotiate
Yes
Send
Estimate to
up to three
contractors
Contractor
gets
estimate
Receive
bids
Can the #'s
work?
Award bid to
contractor
Ask contractor
for revised
prices.
Yes
No
No
Send SOW
estimate/budget
to lender for
approval
Schedule
lender for
inspection
Is lender willing
to lend?
Is he willing to
fund full
amount?
Yes
Identify
new
lender
No
Podio creates
task for finance
to identify
remaining
funds source
Yes
No
Podio
creates task
to Complete
underwriting
process
Finalize
contract,
SOW and
Materials list
Review final
SOW,
contract and
materials
Does SOW
includes Roof,
foundation or
under ground
plumbing?
Yes
Schedule for
day after
closing?
Complete
pre-closing
checklist via
Podio.
Insurance
Key Code
Utilities
Pod
House Closed?
Update Lender,
Utilites,
Insurance of
new date
Order
Materials
Yes
No
Notifiy
Contractor
for start date
Ask for
better
price?
Ask for first draw
from Lender
Send money to
Vendor for Draw
Invoice Sent
Weekly
Checklist in
Podio for
SOW
Has major step
been Complete &
Approved
Podio Notifies
Finance &
Vendor
Yes
Lender draw
process
Has money
been recieved
Yes
No
Invoice Sent
Is this final
payment
Deposit funds
Yes
No
Punchlist
Walkthrough for
each Vendor
Is work
complete?
Vendor
completes work
Yes
No
Complete
punchlist in
Podio
Podio notifies
Finance of final
payment
Final check is cut
Step payment
process
No
Did SOW
change?
PC get approval
from Intregrator
Was it
approved?
Admin updates
SOW and Vendor
Contract
Yes
No
Yes
No
No
Podio creates task for
admin to order
photographer
Pictures taken
Podio Notifies
Realitor
Get sales price
guidance from
Intregrator
Property is ready
for Marketing
Could
Renegotiate?
No
Project
Terminated
Yes
Follow Up
Process
Owner Notifies or
House is Sold to
other party?
Yes
Fix & Flip Process Map
