Virtual Environments Altering the “Cost = Risk” Equation Agenda Technology Introduction Relationship to Construction Technologies Waste Reduction The “Risk = Cost” Equation

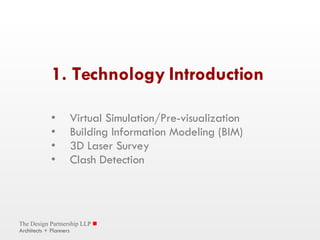

1. Technology Introduction   Virtual Simulation/Pre-visualization Building Information Modeling (BIM) 3D Laser Survey Clash Detection
Virtual Environments Pre-visualization Simulation

Virtual Equipment Simulation

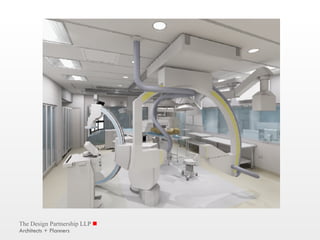

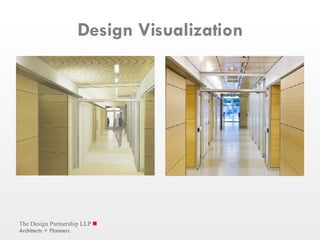

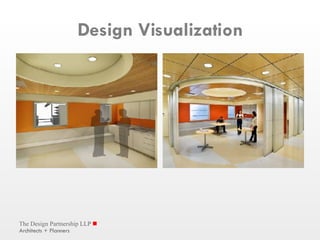

Design Visualization
Design Visualization
Building Information  Modeling (BIM)

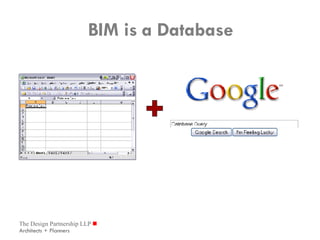

BIM is a Database

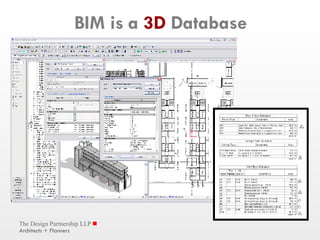

BIM is a  3D  Database

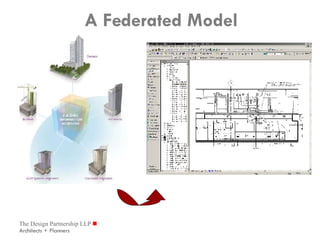

A Federated Model
High Definition Scanning (3D Laser Scanning)

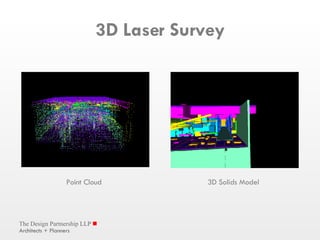

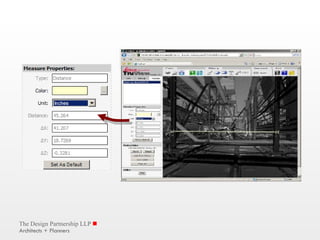

3D Laser Survey Point Cloud 3D Solids Model

Clash Detection (Pre-coordination)

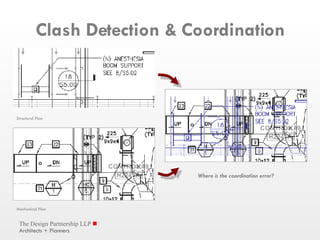

Clash Detection & Coordination Where is the coordination error? Structural Plan Mechanical Plan

2. Relationship to Current Construction Technology 3D Shop Drawings Direct Fabrication Prefabrication
3D Shop Drawings

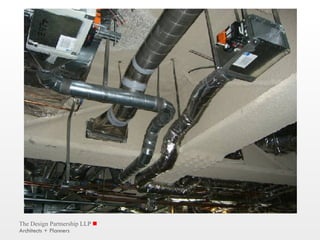

Image courtesy of Marelich Mechanical
Image courtesy of Marelich Mechanical

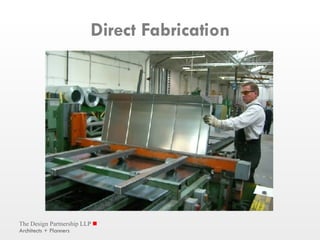

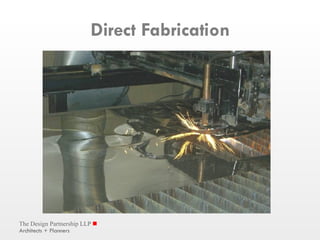

Direct Fabrication

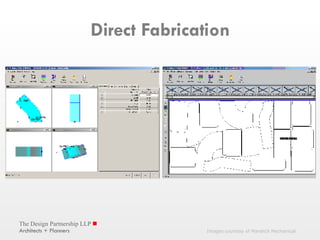

Images courtesy of Marelich Mechanical Direct Fabrication
Direct Fabrication

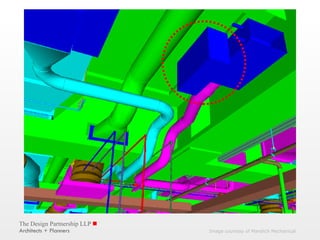

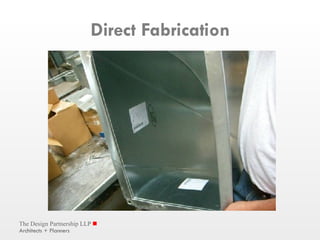

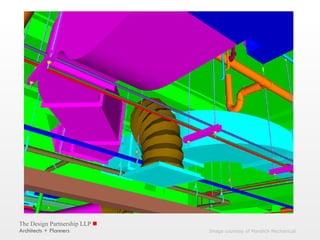

Direct Fabrication
Direct Fabrication

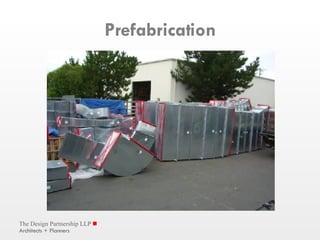

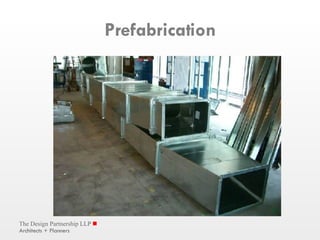

Prefabrication
Prefabrication
Prefabrication
Prefabrication
Prefabrication

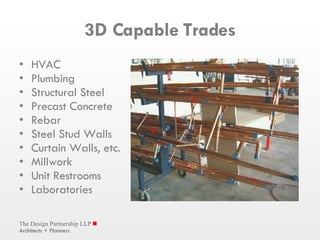

HVAC Plumbing Structural Steel Precast Concrete Rebar Steel Stud Walls Curtain Walls, etc. Millwork Unit Restrooms Laboratories 3D Capable Trades

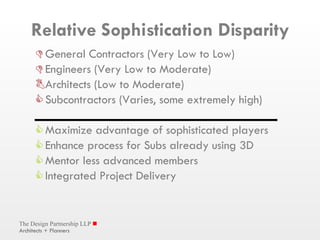

Relative Sophistication Disparity General Contractors (Very Low to Low) Engineers (Very Low to Moderate) Architects (Low to Moderate) Subcontractors (Varies, some extremely high) Maximize advantage of sophisticated players Enhance process for Subs already using 3D Mentor less advanced members Integrated Project Delivery
3. Waste Reduction In Design In the Shop In the Field

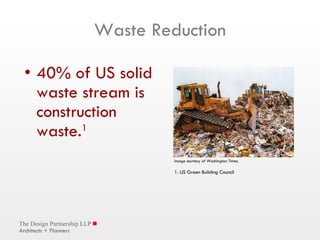

Waste Reduction 40% of US solid waste stream is construction waste. 1 Image courtesy of Washington Times. 1. US Green Building Council
Waste Reduction
Waste Reduction in Design

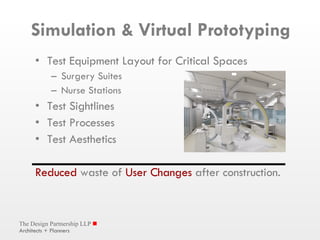

Test Equipment Layout for Critical Spaces Surgery Suites Nurse Stations Test Sightlines Test Processes Test Aesthetics Reduced  waste of  User Changes  after construction. Simulation & Virtual Prototyping

Reduced Document Coordination Effort No duplication of effort between A/E Real-time Project Metrics Time for  Efficient Design  &  Systems Coordination Documentation Waste
Waste Reduction in the Shop
Images courtesy of Marelich Mechanical Efficiency Algorithms
No Part Duplication
Waste Reduction in the Field

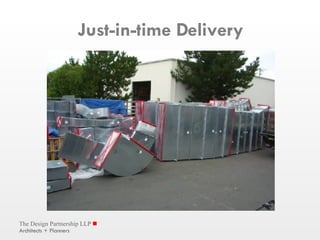

Just-in-time Delivery
Image courtesy of Marelich Mechanical

Image courtesy of Marelich Mechanical

4. “Risk = Cost” Equation Decrease in Contractor’s Risk Decrease in Owner’s Risk Increase in Architect’s Exposure Reduced Risk for All = Reduced Cost

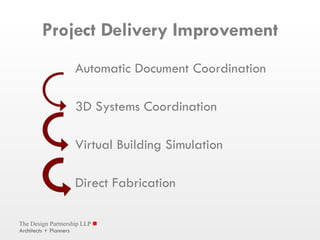

Automatic Document Coordination 3D Systems Coordination Virtual Building Simulation Direct Fabrication Project Delivery Improvement

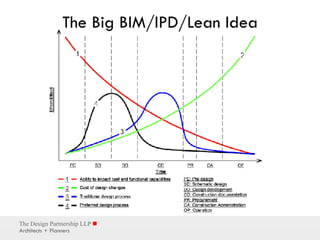

The Big BIM/IPD/Lean Idea
Reduced Coordination Errors Reduced Unknown Conditions More Efficient Workflow Cooperation & Collaboration Reduced Contingency    Increased  Confidence  &    Reduced  Risk Decrease in Contractor’s Risk

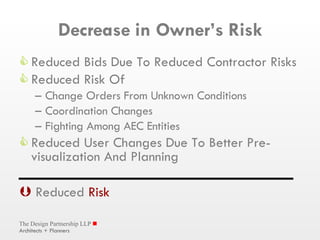

Decrease in Owner’s Risk Reduced Bids Due To Reduced Contractor Risks Reduced Risk Of  Change Orders From Unknown Conditions Coordination Changes Fighting Among AEC Entities Reduced User Changes Due To Better Pre-visualization And Planning    Reduced  Risk
Unknown Consequences Of Sharing BIM Information Design Only Information In BIM Model Extensive Pre-coordination Fabrication From Design Models   Increased  Exposure  to Risk Increase in Architect’s Exposure

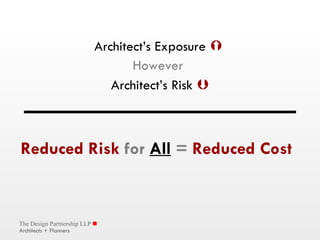

Reduced Risk  for  All  =  Reduced Cost   Architect’s Exposure    However  Architect’s Risk  
Recent Results
Recent Results RFI’s 53 Total 8 Due to AE Documentation Mistakes Cost Bid at $4.28 million ( 37% Under Budget ) Final Cost $4.72 million (10.32% Cost Increase) Primarily Added Scope from Owner Requests $62,000 Unexpected ( 1.3% add to bid price )
Questions? Thank you for your time. Sincerely, Eric Peabody & Andrew Kim
