Indus Tasks Data Analysis & Estimated Time Standardization
1
Idea:
• The estimated vs. resolution time differences in some projects and/or tasks.
• Standardization of the estimated time for each project and task type.

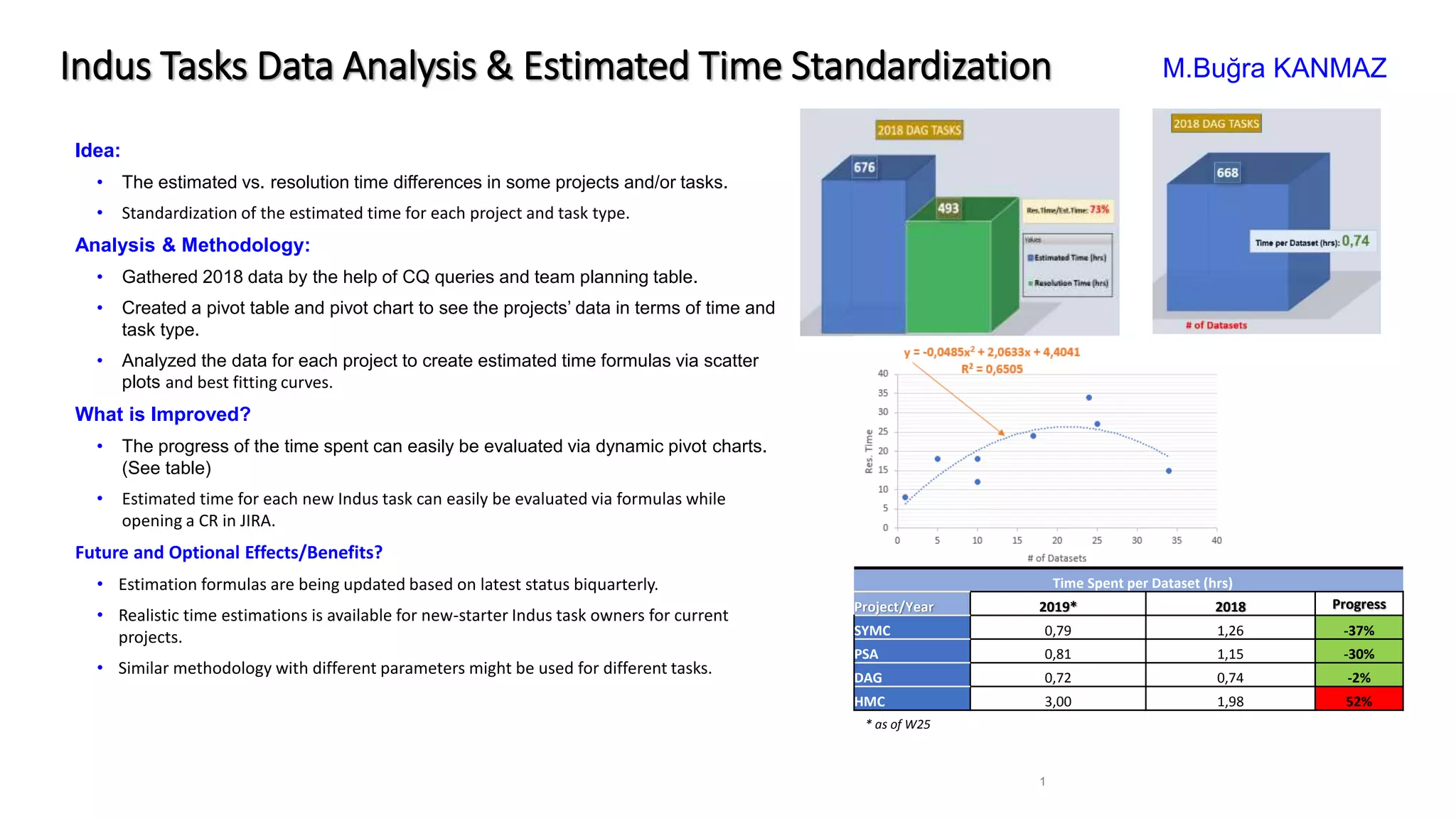

Analysis & Methodology:
• Gathered 2018 data by the help of CQ queries and team planning table.
• Created a pivot table and pivot chart to see the projects’ data in terms of time and
task type.
• Analyzed the data for each project to create estimated time formulas via scatter
plots and best fitting curves.
What is Improved?
• The progress of the time spent can easily be evaluated via dynamic pivot charts.
(See table)
• Estimated time for each new Indus task can easily be evaluated via formulas while
opening a CR in JIRA.
Future and Optional Effects/Benefits?
• Estimation formulas are being updated based on latest status biquarterly.
• Realistic time estimations is available for new-starter Indus task owners for current
projects.
• Similar methodology with different parameters might be used for different tasks.
M.Buğra KANMAZ
Time Spent per Dataset (hrs)
Project/Year 2019* 2018 Progress
SYMC 0,79 1,26 -37%
PSA 0,81 1,15 -30%
DAG 0,72 0,74 -2%
HMC 3,00 1,98 52%
* as of W25

Basic Data Analysis with Regression

  • 1.
    Indus Tasks DataAnalysis & Estimated Time Standardization 1 Idea: • The estimated vs. resolution time differences in some projects and/or tasks. • Standardization of the estimated time for each project and task type. Analysis & Methodology: • Gathered 2018 data by the help of CQ queries and team planning table. • Created a pivot table and pivot chart to see the projects’ data in terms of time and task type. • Analyzed the data for each project to create estimated time formulas via scatter plots and best fitting curves. What is Improved? • The progress of the time spent can easily be evaluated via dynamic pivot charts. (See table) • Estimated time for each new Indus task can easily be evaluated via formulas while opening a CR in JIRA. Future and Optional Effects/Benefits? • Estimation formulas are being updated based on latest status biquarterly. • Realistic time estimations is available for new-starter Indus task owners for current projects. • Similar methodology with different parameters might be used for different tasks. M.Buğra KANMAZ Time Spent per Dataset (hrs) Project/Year 2019* 2018 Progress SYMC 0,79 1,26 -37% PSA 0,81 1,15 -30% DAG 0,72 0,74 -2% HMC 3,00 1,98 52% * as of W25
