Wind Turbine Project
                   2011-2012




Harry McGrath
Production Director
Feb 2012
Global Performer


50
  £110
years

            million


800
employees
Global Performer



5  Continents



  74               Countries




50%
Export sales
Multi Site Operations

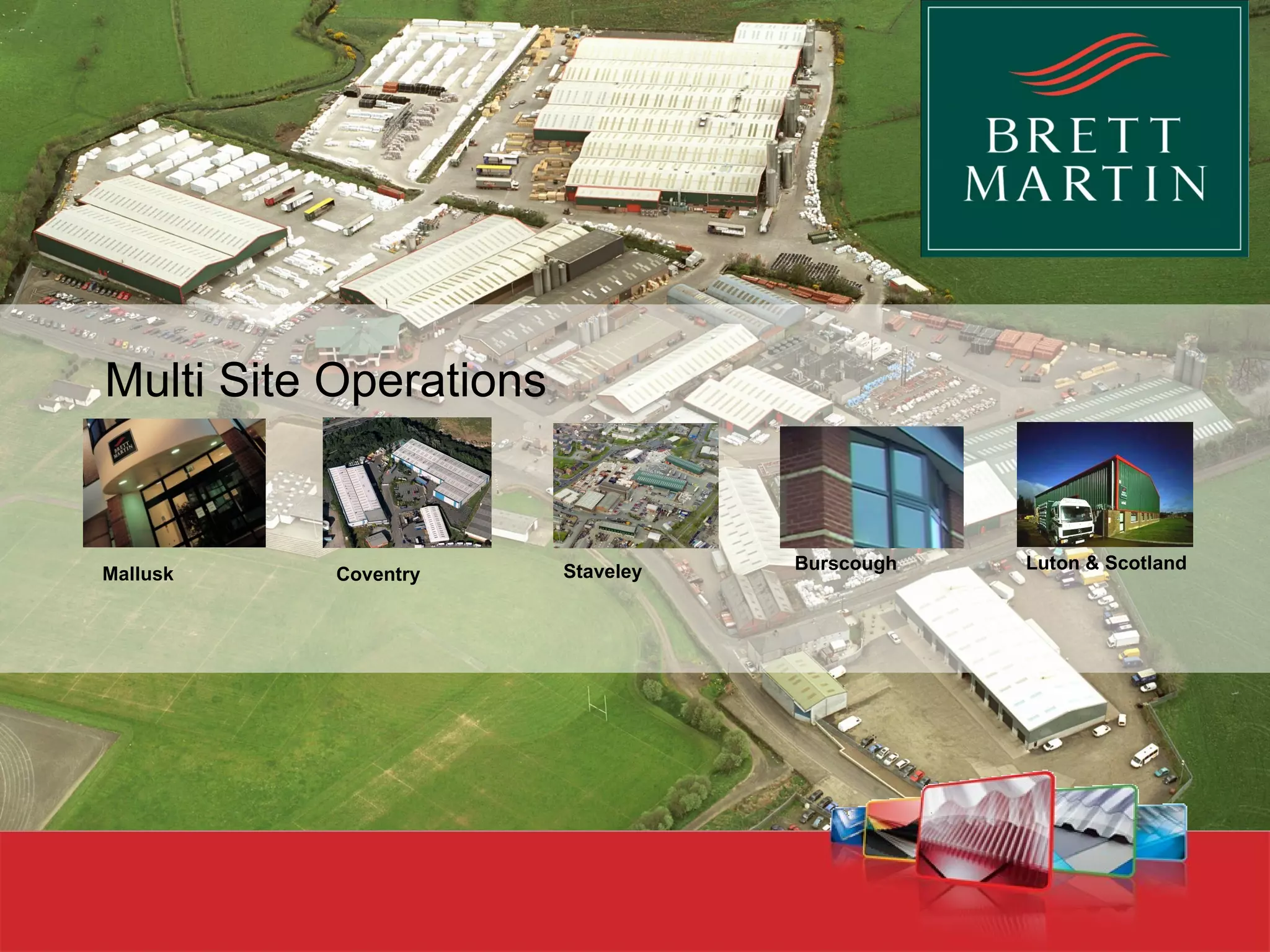

                        Staveley   Burscough   Luton & Scotland
Mallusk   Coventry

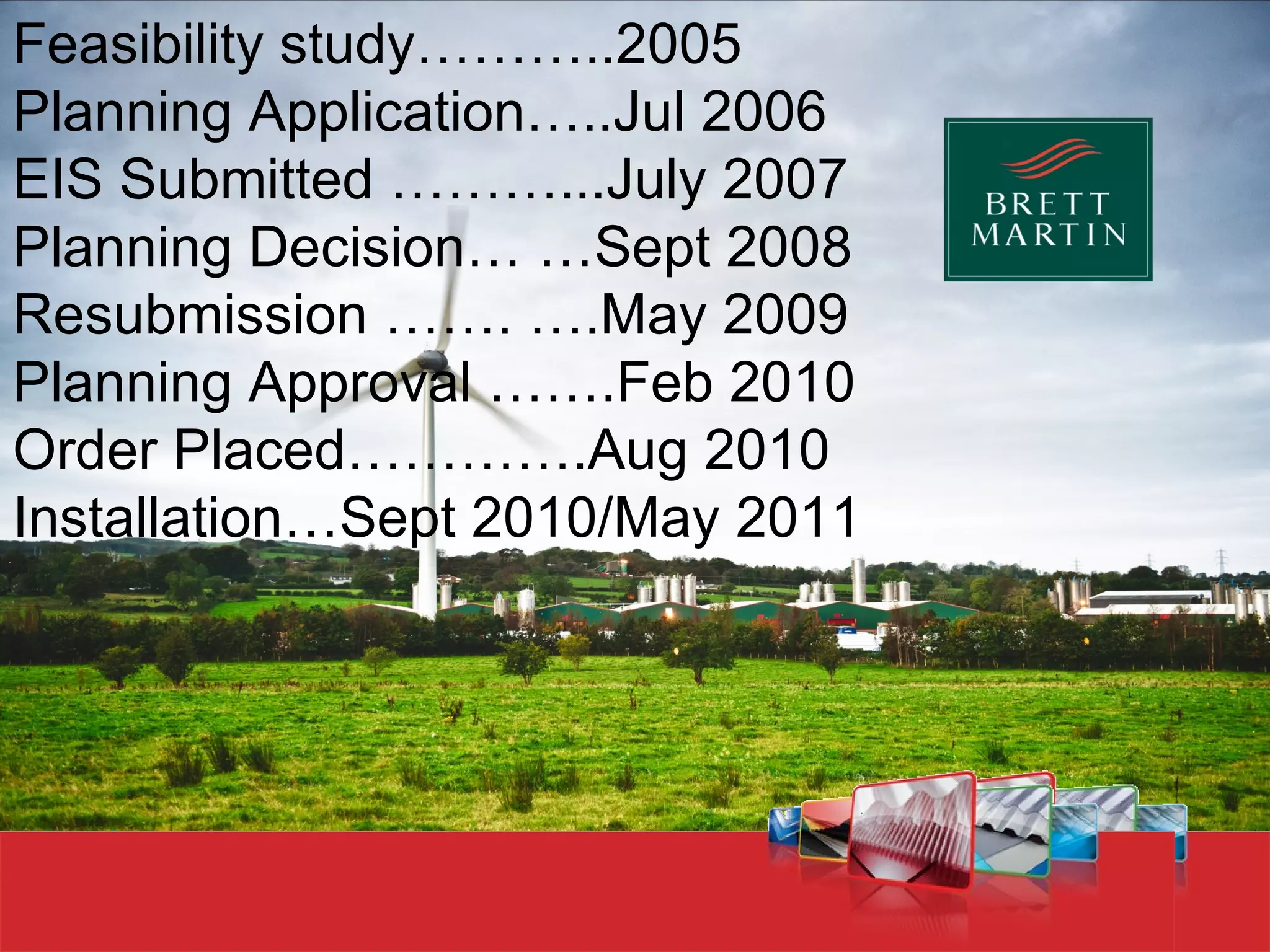

Feasibility study………..2005
Planning Application…..Jul 2006
EIS Submitted ………...July 2007
Planning Decision… …Sept 2008
Resubmission ……. ….May 2009
Planning Approval …….Feb 2010
Order Placed………….Aug 2010
Installation…Sept 2010/May 2011




www.youtube.com/w

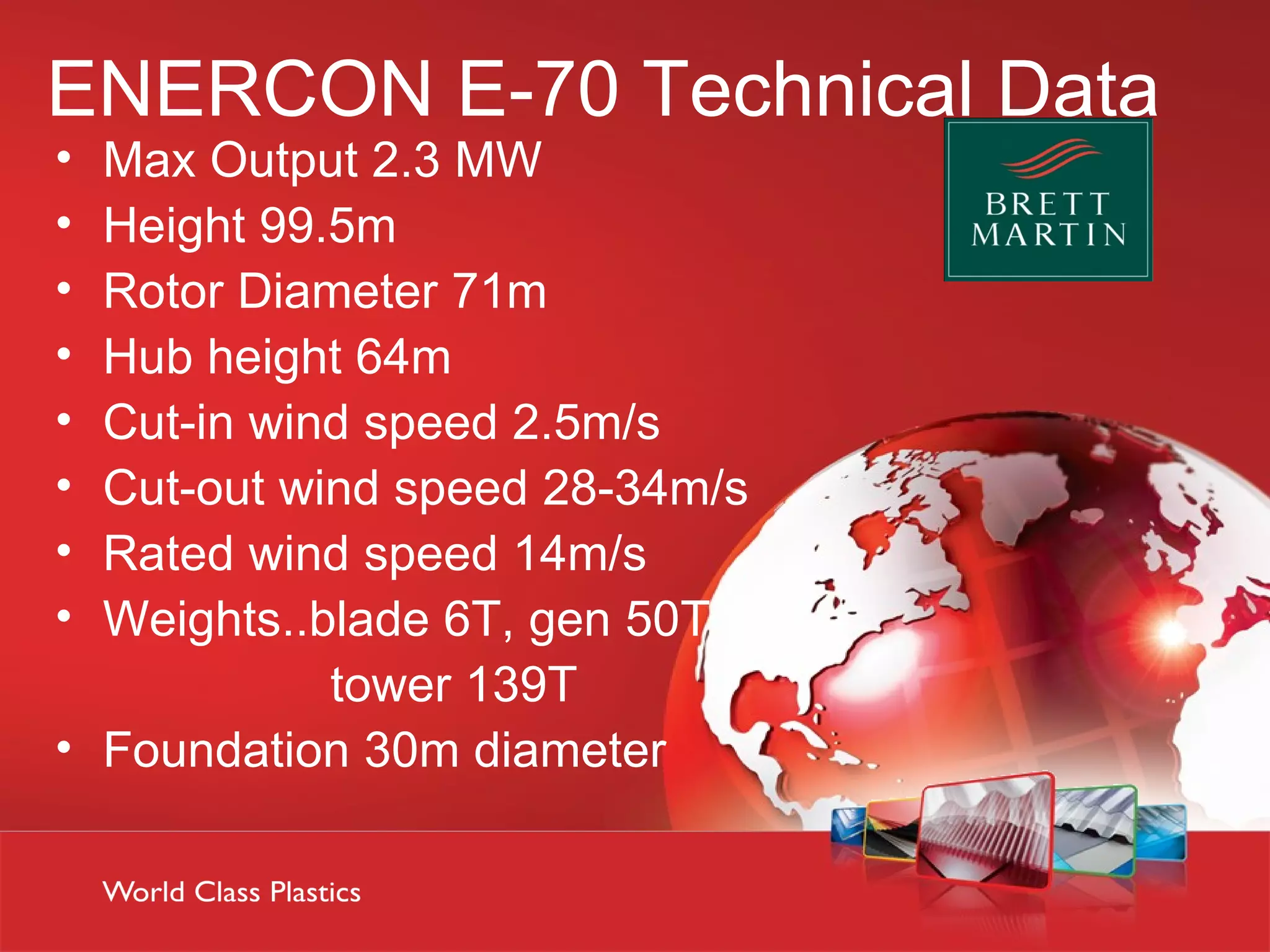

ENERCON E-70 Technical Data
• Max Output 2.3 MW
• Height 99.5m
• Rotor Diameter 71m
• Hub height 64m
• Cut-in wind speed 2.5m/s
• Cut-out wind speed 28-34m/s
• Rated wind speed 14m/s
• Weights..blade 6T, gen 50T
            tower 139T
• Foundation 30m diameter
Costs
•   Planning/Project management £50k+
•   Anemometer hire £20k
•   Foundations £50K
•   Turbine £2mill
•   Cabling/Ducting £40k
Issues to Consider
• Planning/Local Knowledge/PPS 18
• Grid Connectivity/NIE Grid Connection Code
• Height, wildlife, bats, shadow flicker, noise

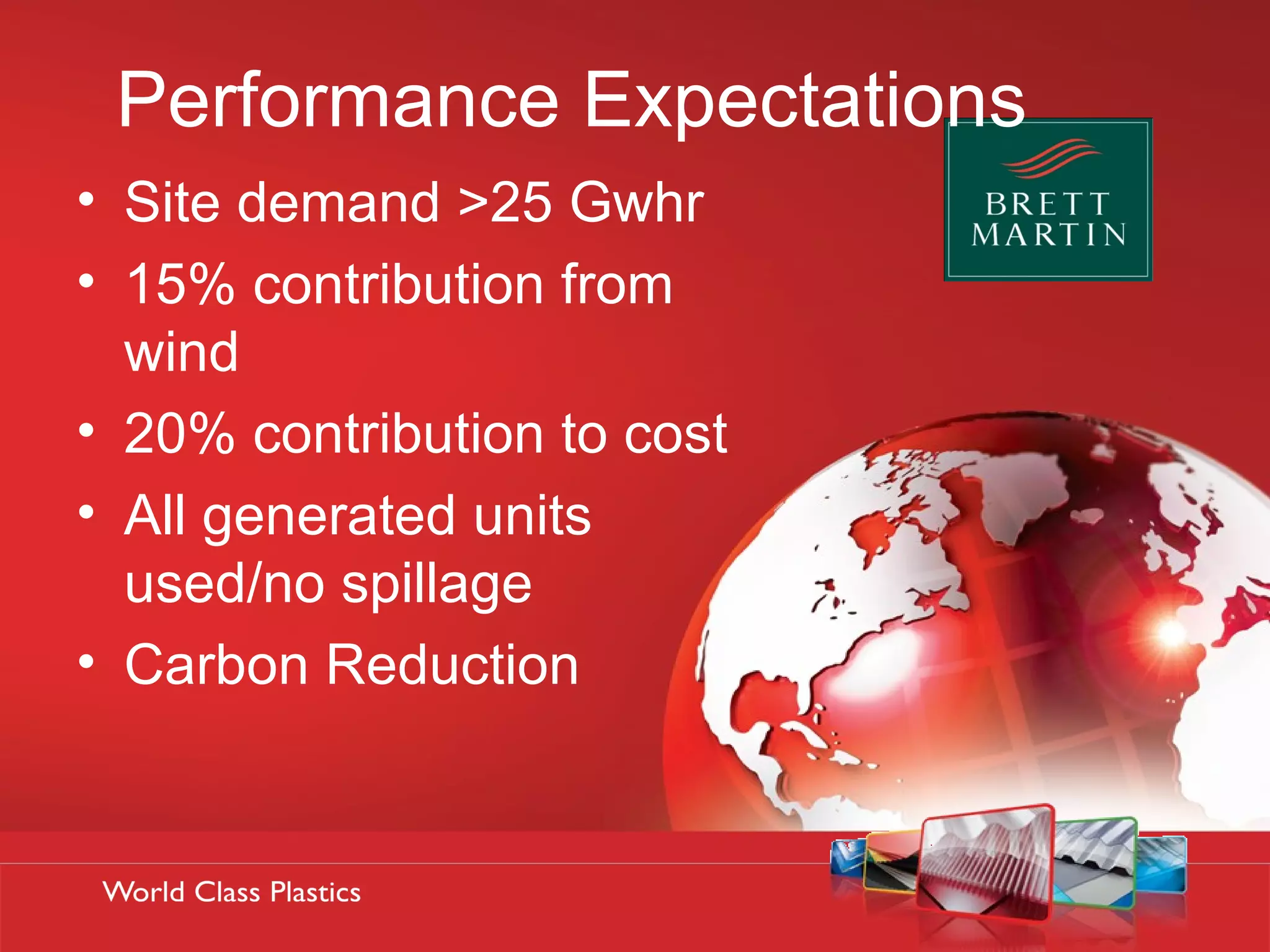

Performance Expectations
• Site demand >25 Gwhr
• 15% contribution from
  wind
• 20% contribution to cost
• All generated units
  used/no spillage
• Carbon Reduction

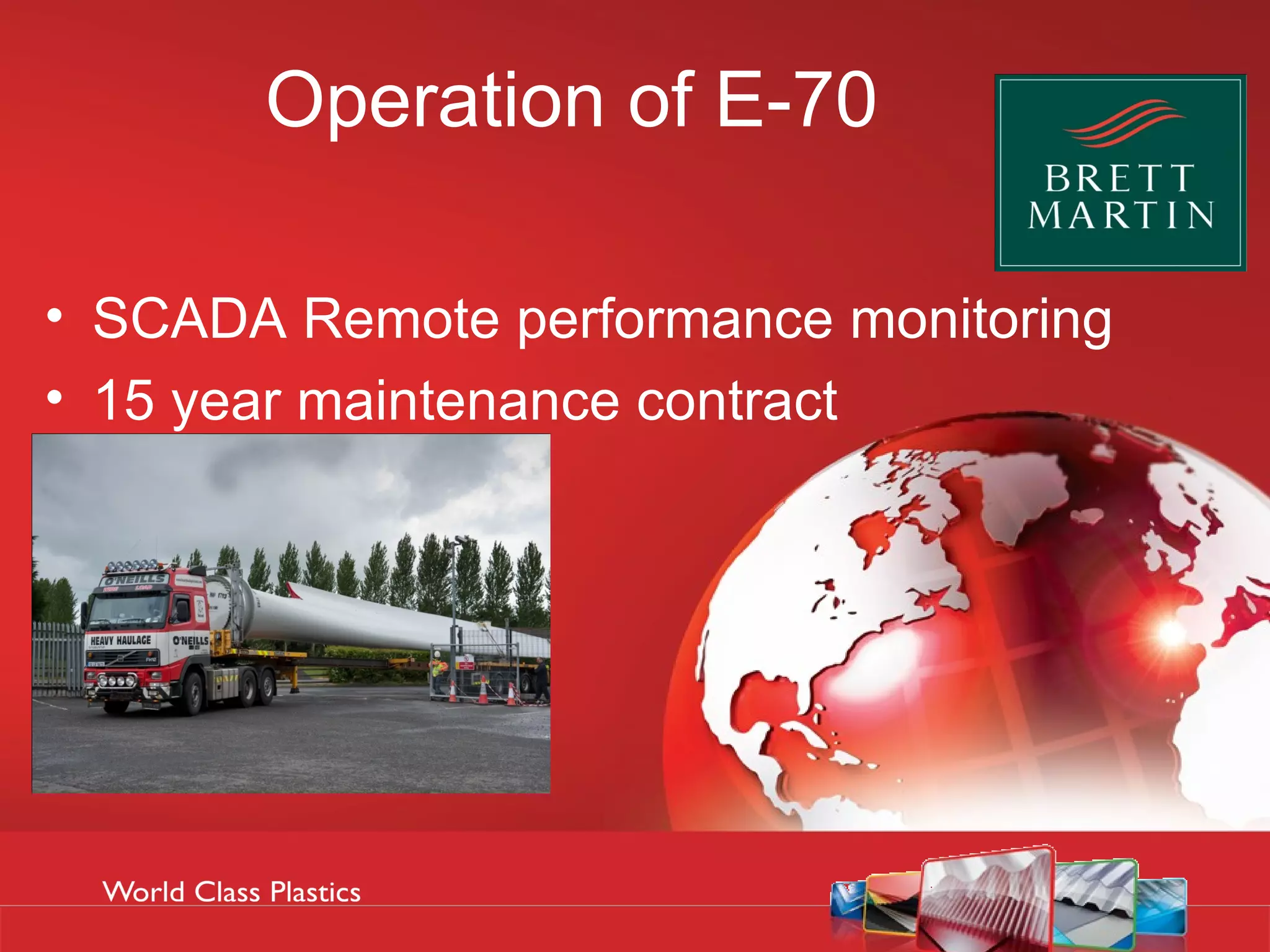

Operation of E-70

• SCADA Remote performance monitoring
• 15 year maintenance contract
Performance to date
• Operational since late June
  2011
• July/Aug low wind speeds!
• Sept to date above average
• Generated 2.5mill units to
  Jan 2012
• Forecast >3 mill
  units/annum
CBI NI energy conference: Harry McGrath

CBI NI energy conference: Harry McGrath

  • 1.
    Wind Turbine Project 2011-2012 Harry McGrath Production Director Feb 2012
  • 2.
    Global Performer 50 £110 years million 800 employees
  • 3.
    Global Performer 5 Continents 74 Countries 50% Export sales
  • 9.
    Multi Site Operations Staveley Burscough Luton & Scotland Mallusk Coventry
  • 10.
    Feasibility study………..2005 Planning Application…..Jul2006 EIS Submitted ………...July 2007 Planning Decision… …Sept 2008 Resubmission ……. ….May 2009 Planning Approval …….Feb 2010 Order Placed………….Aug 2010 Installation…Sept 2010/May 2011 www.youtube.com/w
  • 11.
    ENERCON E-70 TechnicalData • Max Output 2.3 MW • Height 99.5m • Rotor Diameter 71m • Hub height 64m • Cut-in wind speed 2.5m/s • Cut-out wind speed 28-34m/s • Rated wind speed 14m/s • Weights..blade 6T, gen 50T tower 139T • Foundation 30m diameter
  • 12.
    Costs • Planning/Project management £50k+ • Anemometer hire £20k • Foundations £50K • Turbine £2mill • Cabling/Ducting £40k
  • 13.
    Issues to Consider •Planning/Local Knowledge/PPS 18 • Grid Connectivity/NIE Grid Connection Code • Height, wildlife, bats, shadow flicker, noise
  • 14.
    Performance Expectations • Sitedemand >25 Gwhr • 15% contribution from wind • 20% contribution to cost • All generated units used/no spillage • Carbon Reduction
  • 15.
    Operation of E-70 •SCADA Remote performance monitoring • 15 year maintenance contract
  • 16.
    Performance to date •Operational since late June 2011 • July/Aug low wind speeds! • Sept to date above average • Generated 2.5mill units to Jan 2012 • Forecast >3 mill units/annum
