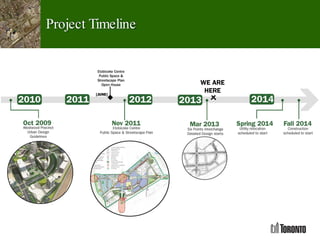

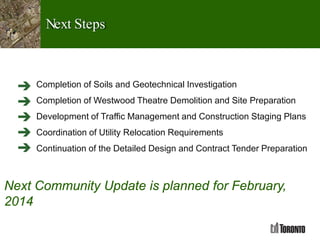

This document provides an update on the reconfiguration of the Six Points Interchange project as of June 17, 2013, detailing its objectives, timeline, and involvement of Build Toronto. Key activities include soil investigations, site preparation, and planning for a new road network. The next community update is scheduled for February 2014, with contact information for further inquiries included.
