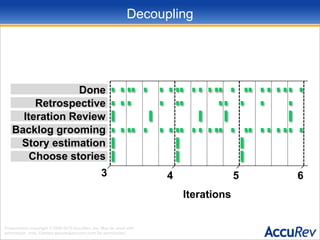

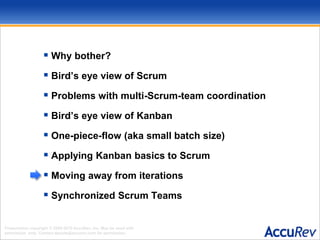

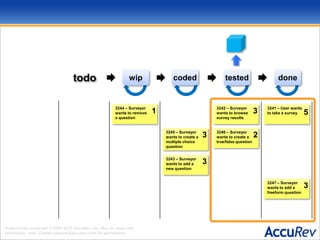

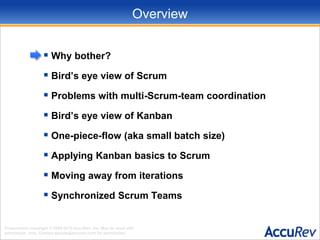

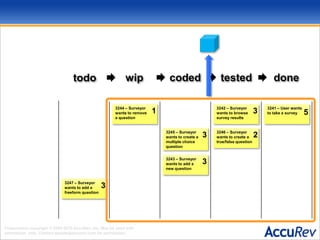

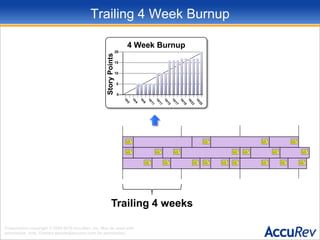

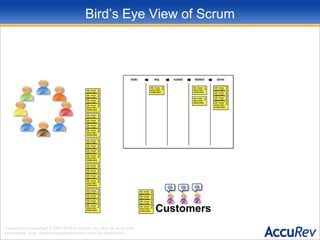

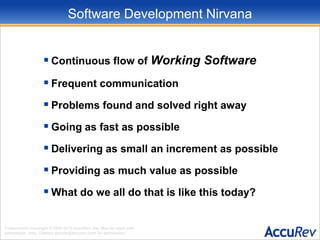

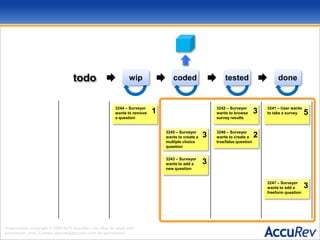

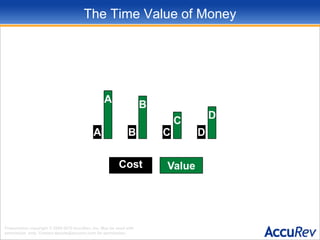

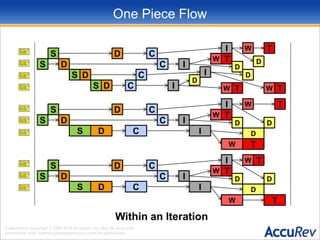

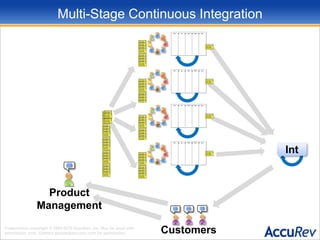

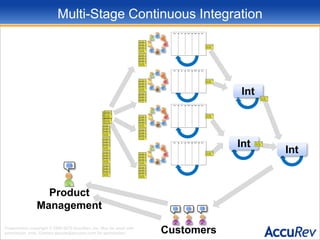

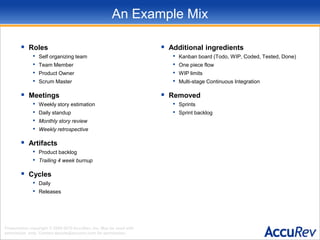

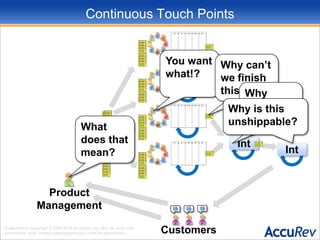

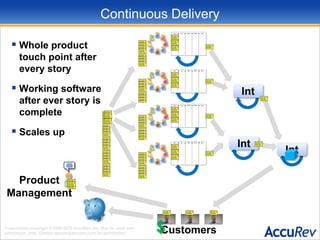

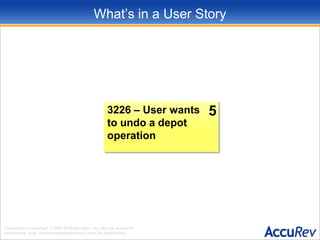

This document discusses synchronizing multiple Scrum teams using Kanban principles. It begins with an overview of Scrum and problems with multi-team coordination. It then provides a overview of Kanban and key concepts like one-piece flow and limiting work-in-progress. The document applies these Kanban concepts to Scrum by removing iterations and instead using completed stories as synchronization points between teams. It advocates for decoupling Scrum activities from iterations to allow continuous work and integration.
