Android Unit Test Framework
http://pivotal.github.com/robolectric
Follow us on twitter: @robolectric
Wednesday, October 27, 2010
Tyler Schultz
Agile Engineer, Pivotal Labs
Wednesday, October 27, 2010

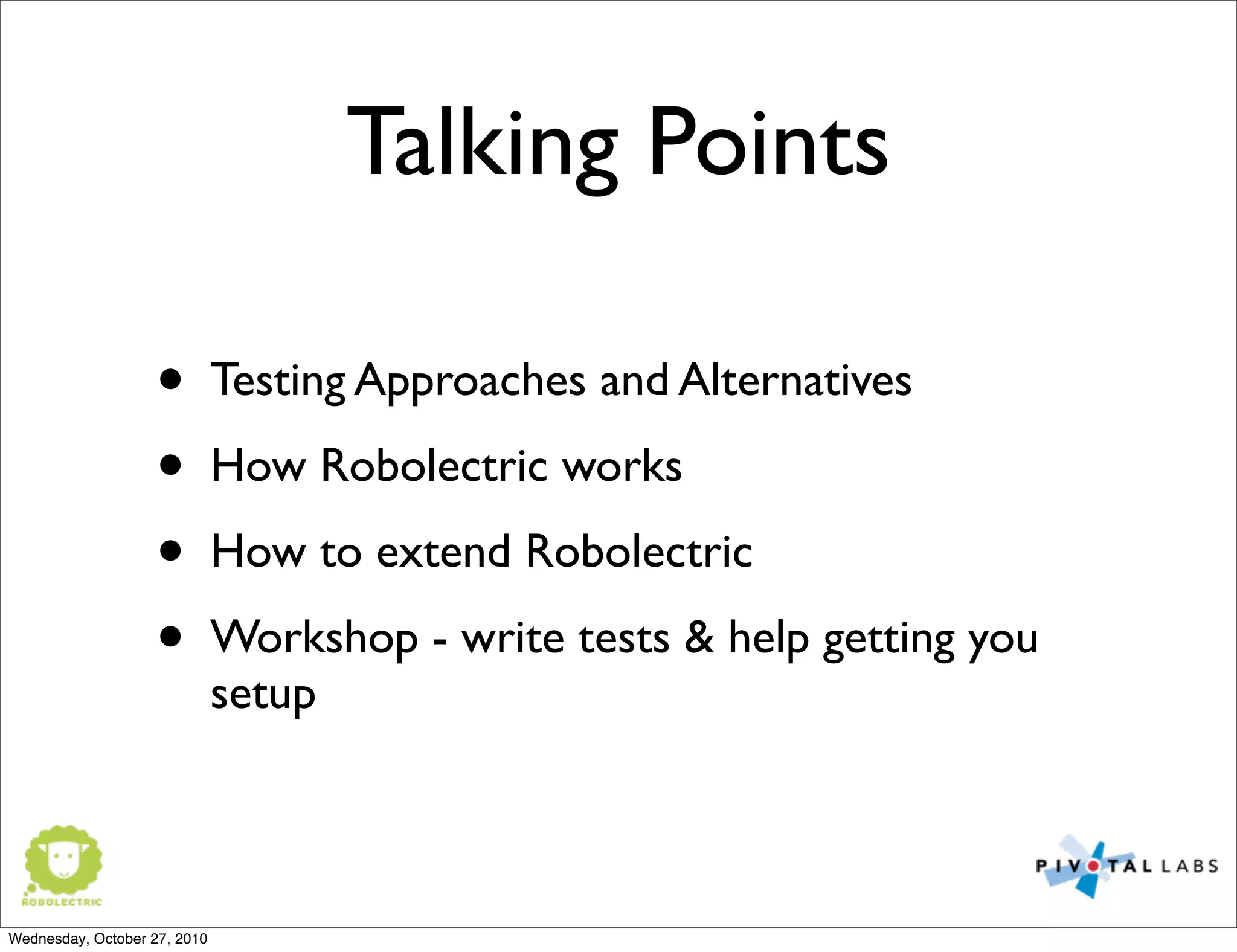

Talking Points
• Testing Approaches and Alternatives
• How Robolectric works
• How to extend Robolectric
• Workshop - write tests & help getting you
setup
Wednesday, October 27, 2010

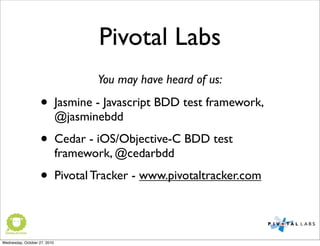

Pivotal Labs
• Jasmine - Javascript BDD test framework,
@jasminebdd
• Cedar - iOS/Objective-C BDD test
framework, @cedarbdd
• Pivotal Tracker - www.pivotaltracker.com
You may have heard of us:
Wednesday, October 27, 2010

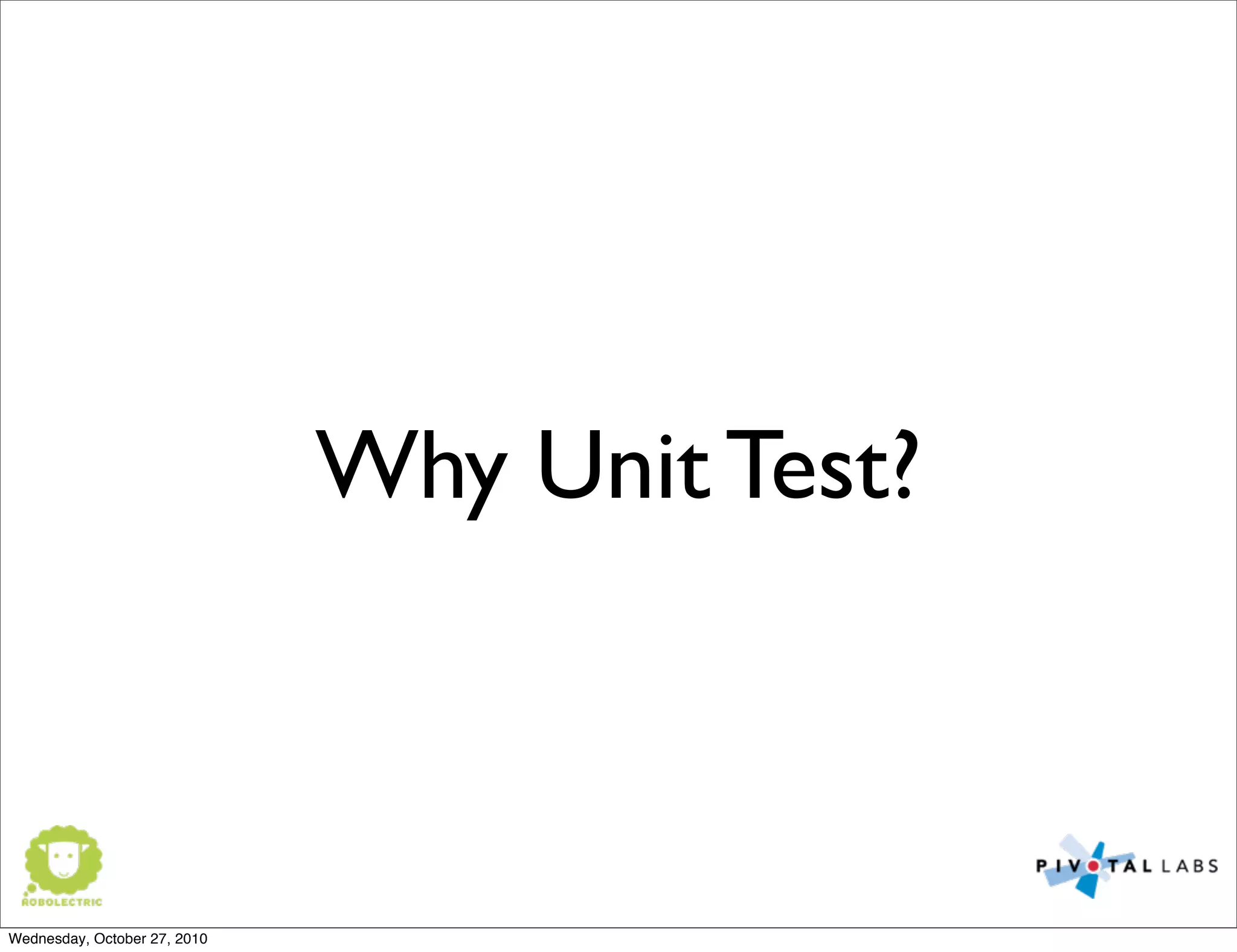

Why Unit Test?
Wednesday, October 27, 2010

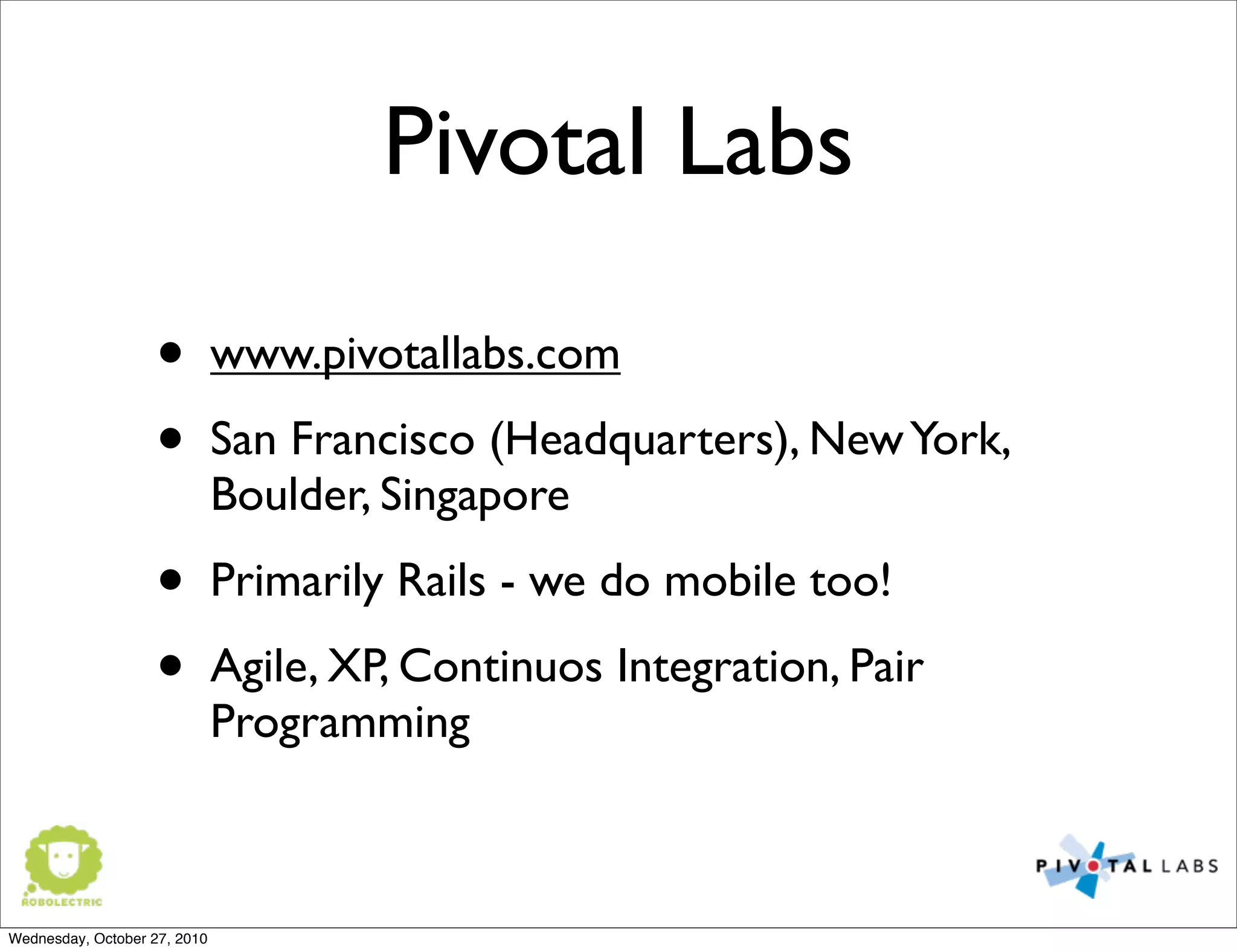

Pivotal Labs
• www.pivotallabs.com
• San Francisco (Headquarters), NewYork,
Boulder, Singapore
• Primarily Rails - we do mobile too!
• Agile, XP, Continuos Integration, Pair
Programming
Wednesday, October 27, 2010

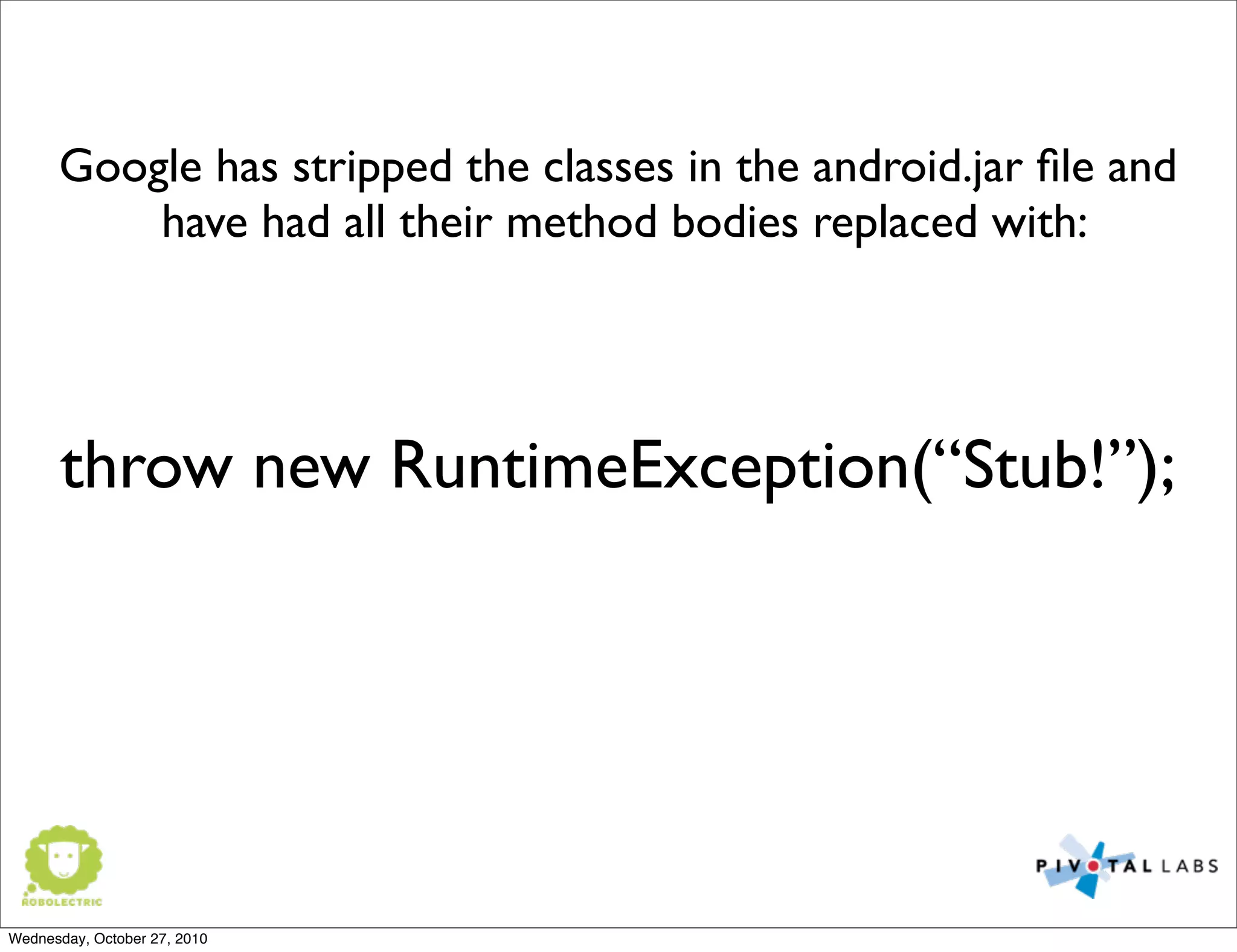

java.lang.RuntimeException(“Stub!”)
Wednesday, October 27, 2010
Google has stripped the classes in the android.jar file and
have had all their method bodies replaced with:
throw new RuntimeException(“Stub!”);
Wednesday, October 27, 2010

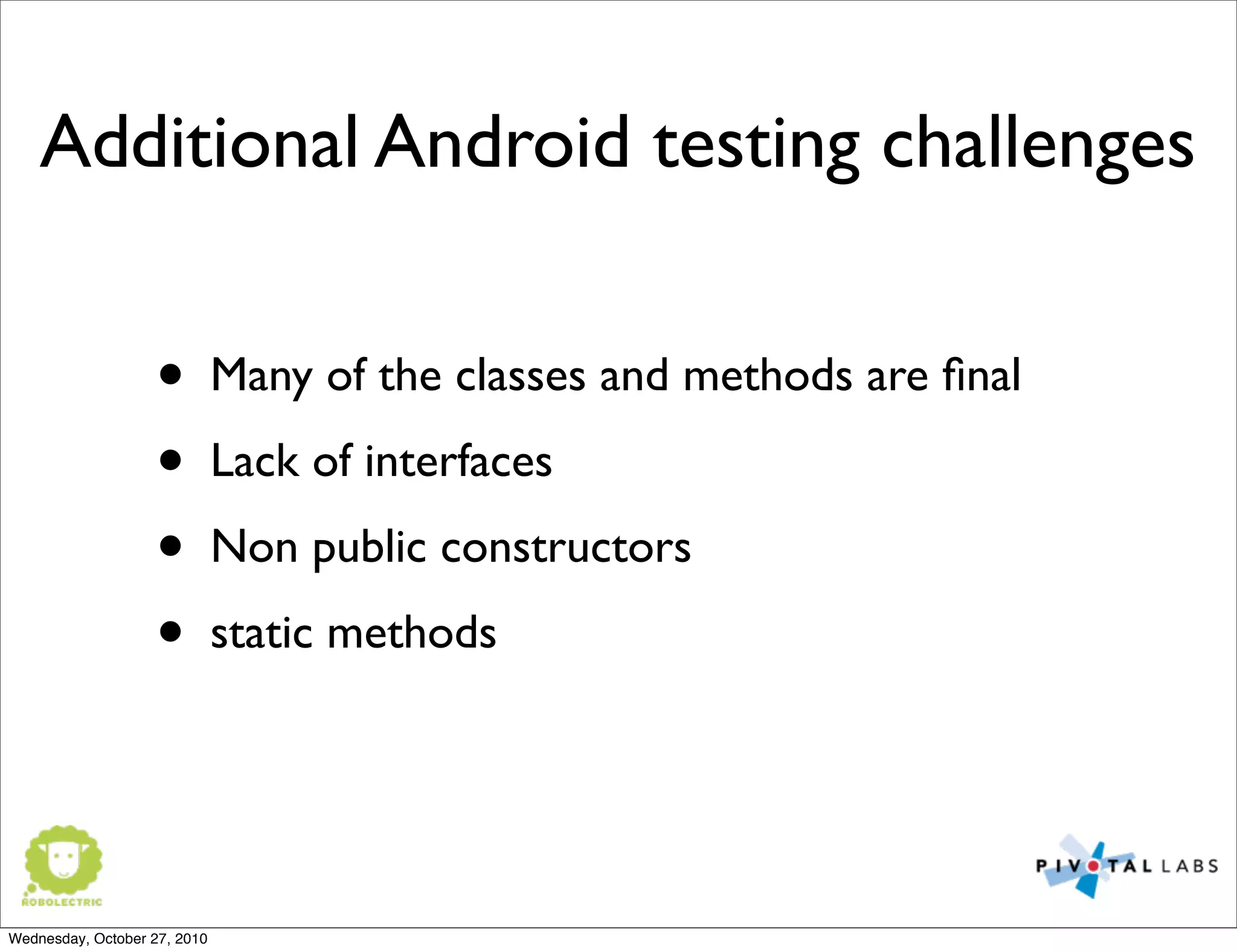

Additional Android testing challenges
• Many of the classes and methods are final
• Lack of interfaces
• Non public constructors
• static methods
Wednesday, October 27, 2010
sfandroid.org members, what have you
been doing?
Wednesday, October 27, 2010
Android Testing
Approaches
Wednesday, October 27, 2010

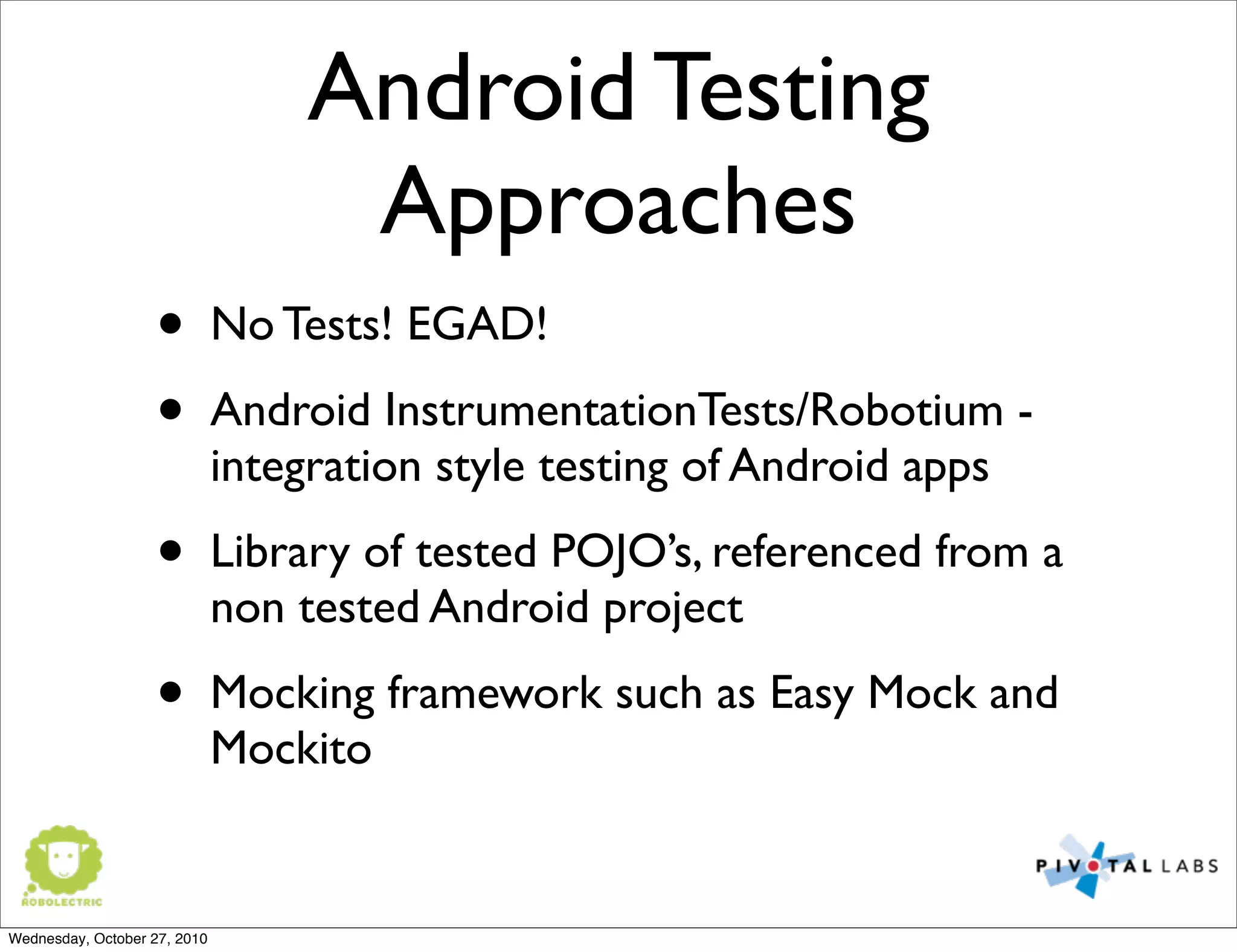

Android Testing
Approaches
• No Tests! EGAD!
• Android InstrumentationTests/Robotium -
integration style testing of Android apps
• Library of tested POJO’s, referenced from a
non tested Android project
• Mocking framework such as Easy Mock and
Mockito
Wednesday, October 27, 2010
Robolectric
Wednesday, October 27, 2010

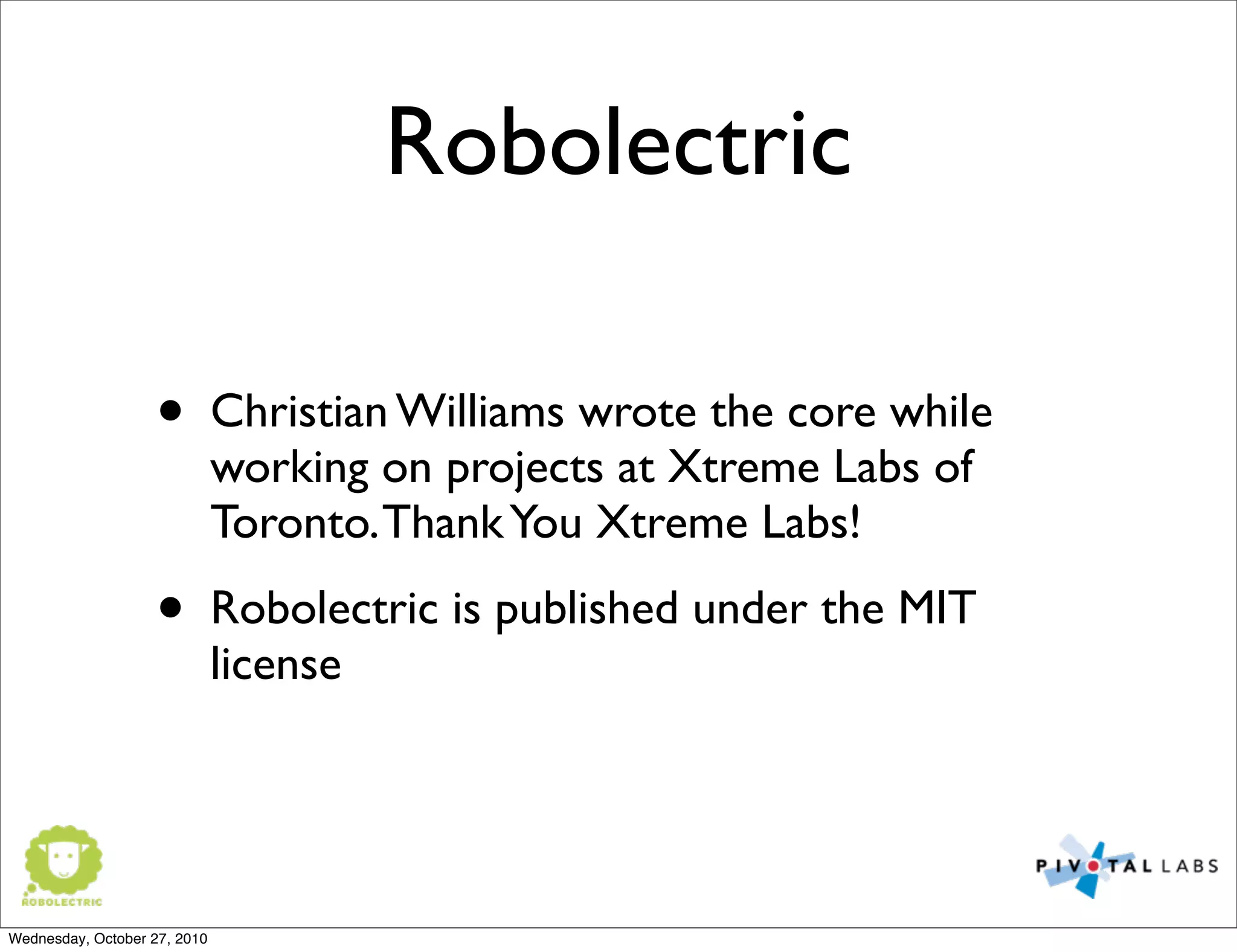

Robolectric
• Christian Williams wrote the core while
working on projects at Xtreme Labs of
Toronto.ThankYou Xtreme Labs!
• Robolectric is published under the MIT
license
Wednesday, October 27, 2010

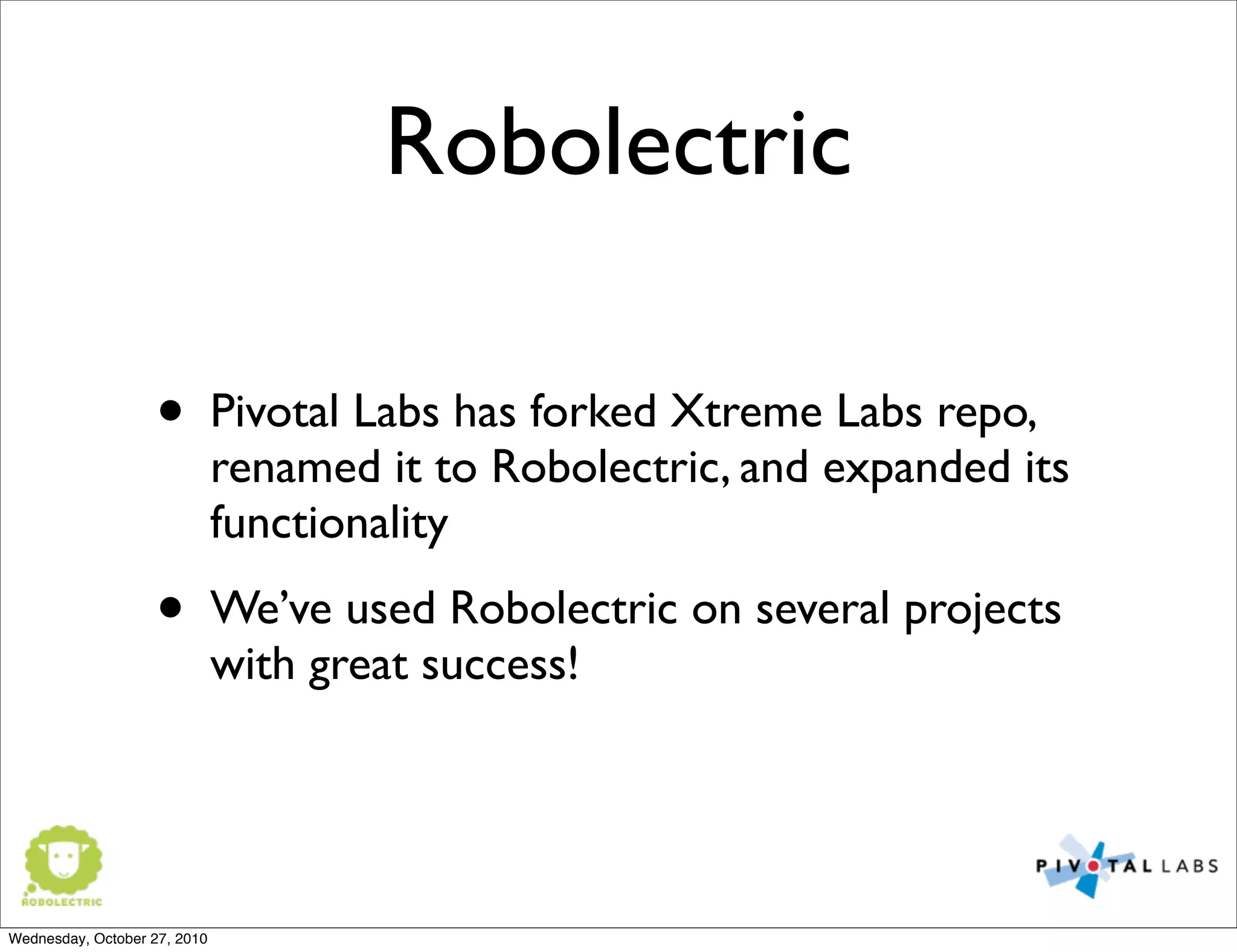

Robolectric
• Pivotal Labs has forked Xtreme Labs repo,
renamed it to Robolectric, and expanded its
functionality
• We’ve used Robolectric on several projects
with great success!
Wednesday, October 27, 2010
Robolectric
Why use Robolectric?
What makes it so great?
Wednesday, October 27, 2010
Why Use Robolectric
vs.Android Instrumentation Tests?
• Tests Run outside of the emulator in a JVM,
not the DalvikVM
- Running in a DalvikVM requires dexing,
packaging and installation on an emulator
or device - slow!
- Tests execute quickly in the JVM and
execute slowly on the emulator
Wednesday, October 27, 2010

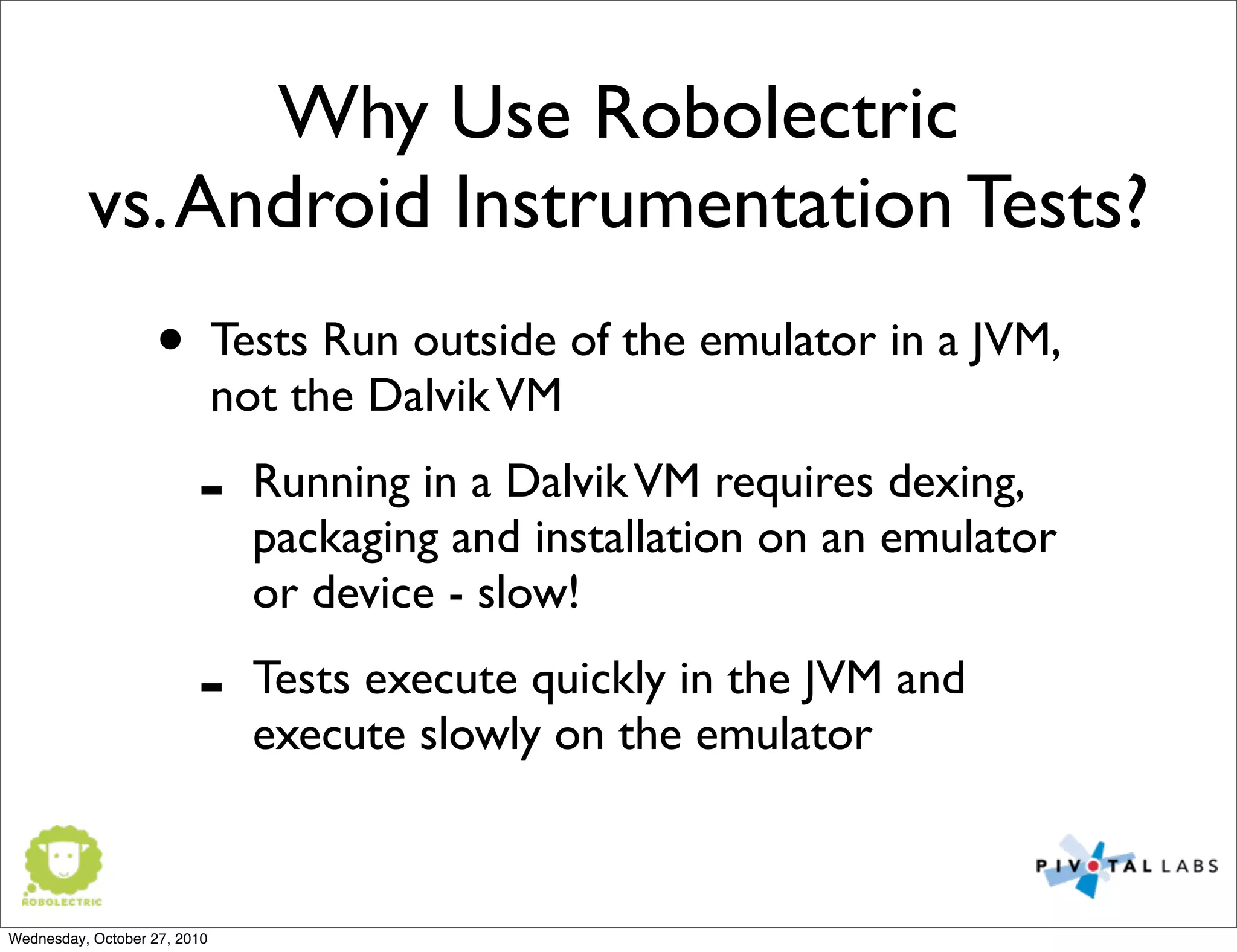

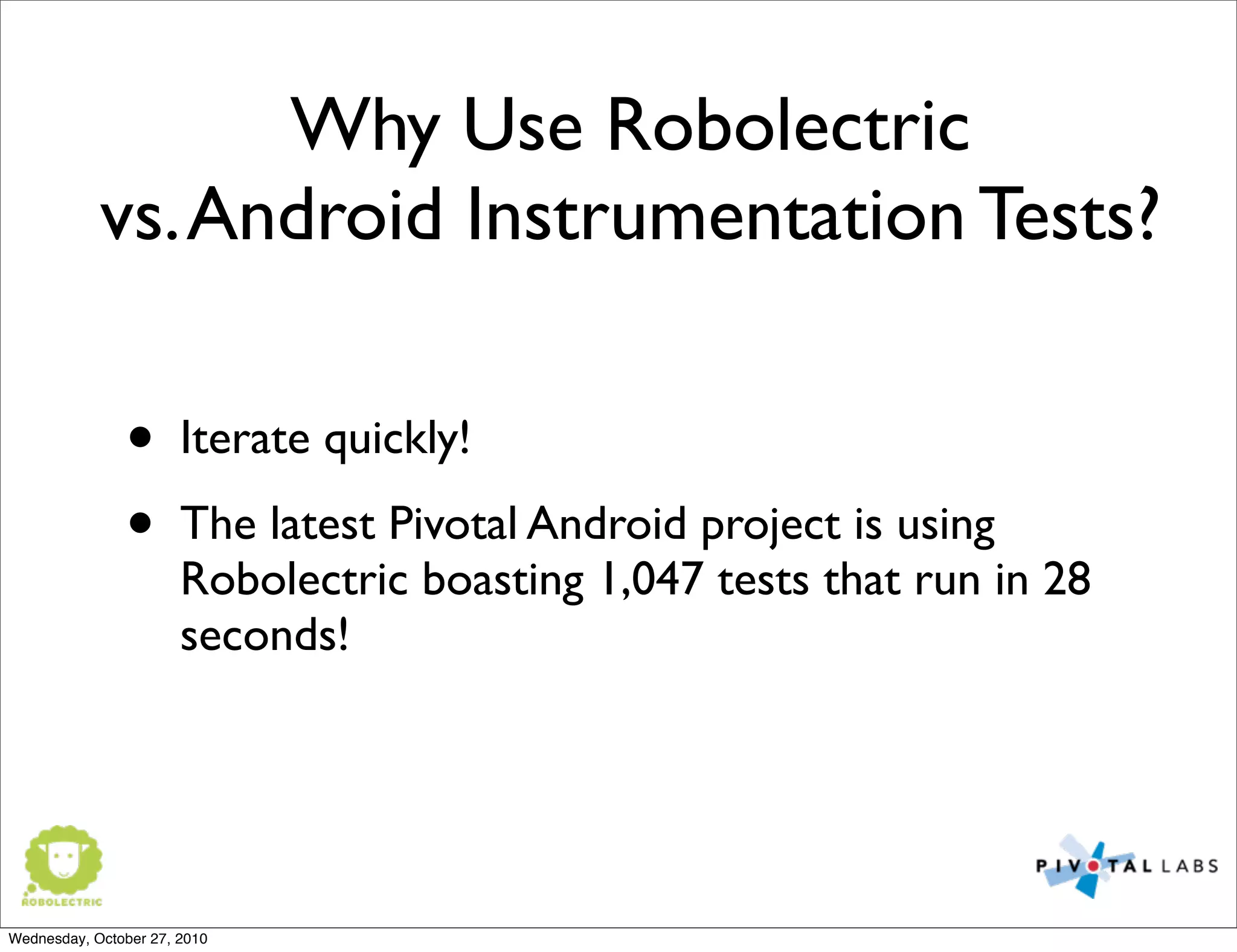

Why Use Robolectric
vs.Android Instrumentation Tests?
• Iterate quickly!
• The latest Pivotal Android project is using
Robolectric boasting 1,047 tests that run in 28
seconds!
Wednesday, October 27, 2010
Why Use Robolectric
vs. POJO lib approach?
• The POJO lib approach leads to code
proliferation, interfaces with multiple
implementations - code bloat!
• Robolectric allows for vastly increased test
coverage. Test ALL your code, not just non-
Android code.
Wednesday, October 27, 2010
• Mocking frameworks can lead to tests that
are reverse implementation of the code
• Can lead to tests that are hard to read
• Can lead to tests that don’t help refactoring

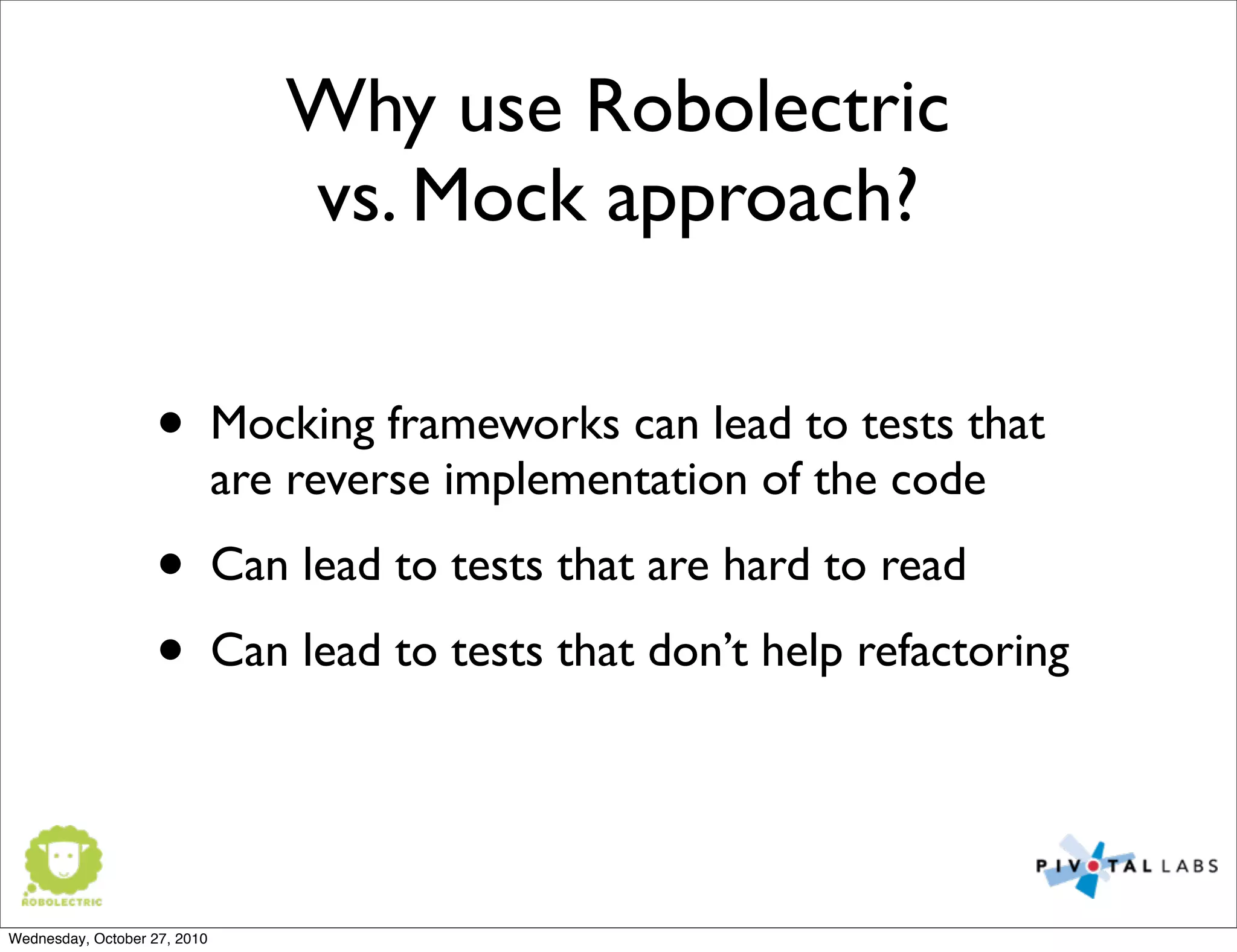

Why use Robolectric
vs. Mock approach?
Wednesday, October 27, 2010

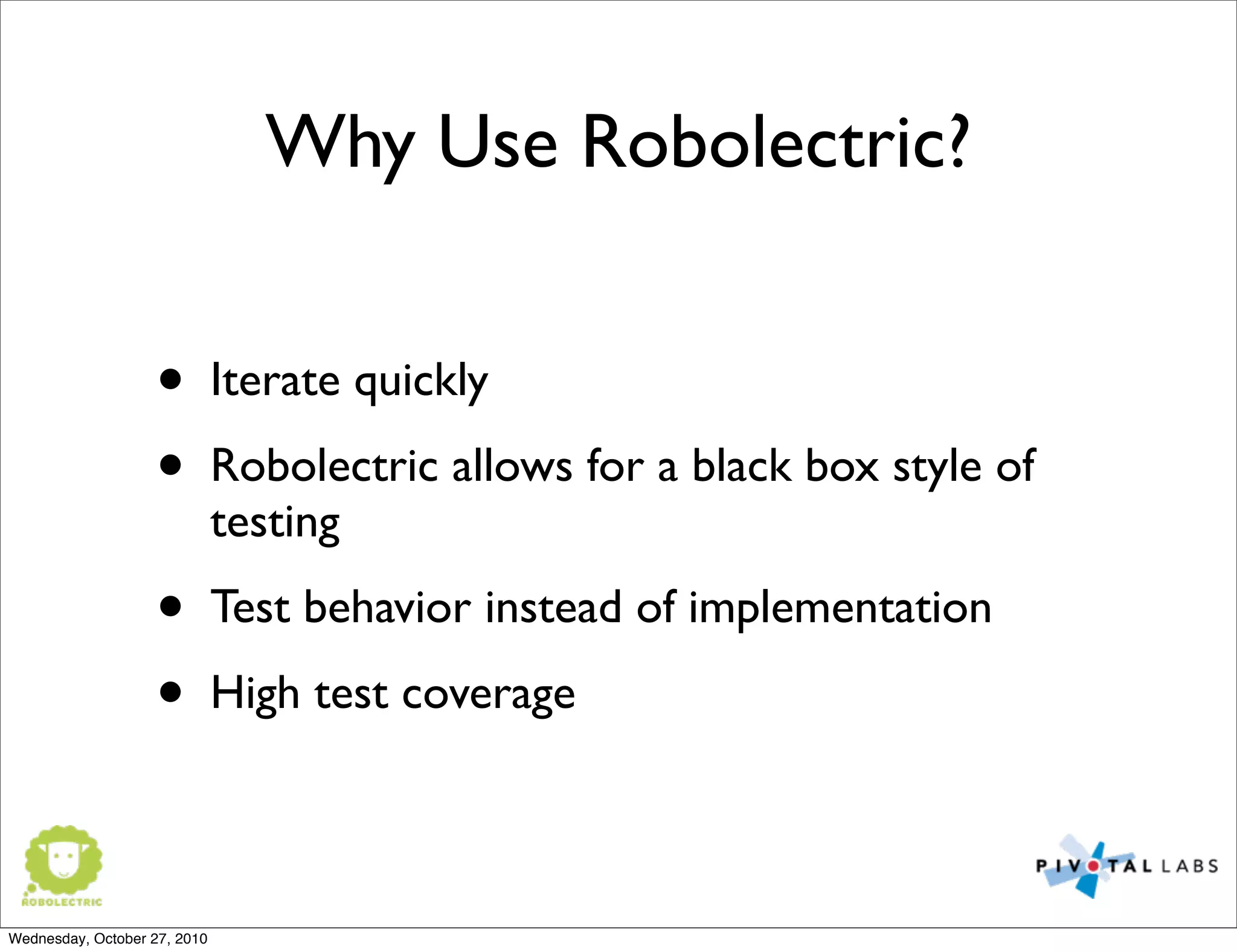

Why Use Robolectric?
• Iterate quickly
• Robolectric allows for a black box style of
testing
• Test behavior instead of implementation
• High test coverage
Wednesday, October 27, 2010

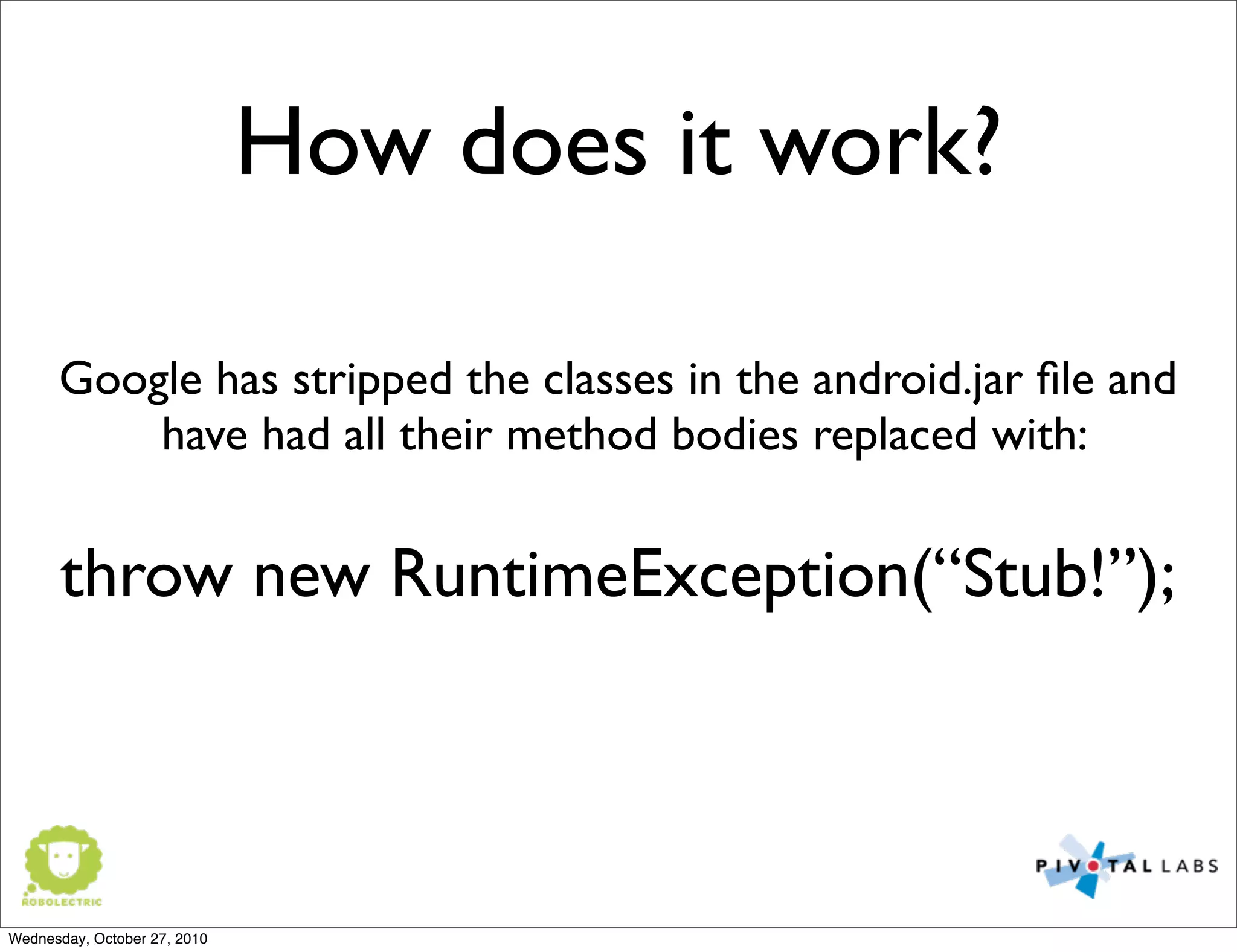

How does it work?
Google has stripped the classes in the android.jar file and
have had all their method bodies replaced with:
throw new RuntimeException(“Stub!”);
Wednesday, October 27, 2010

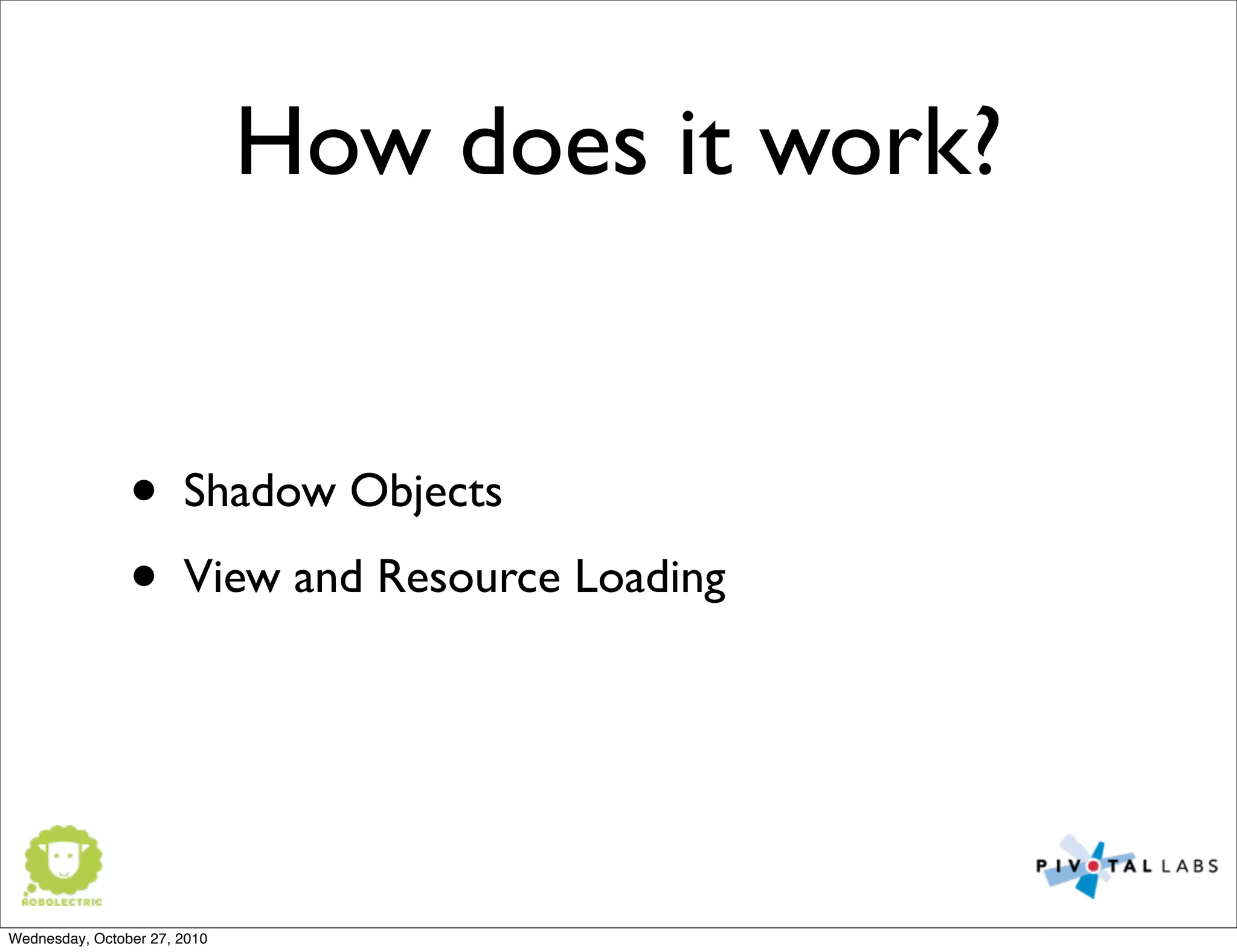

How does it work?
• Shadow Objects
• View and Resource Loading
Wednesday, October 27, 2010

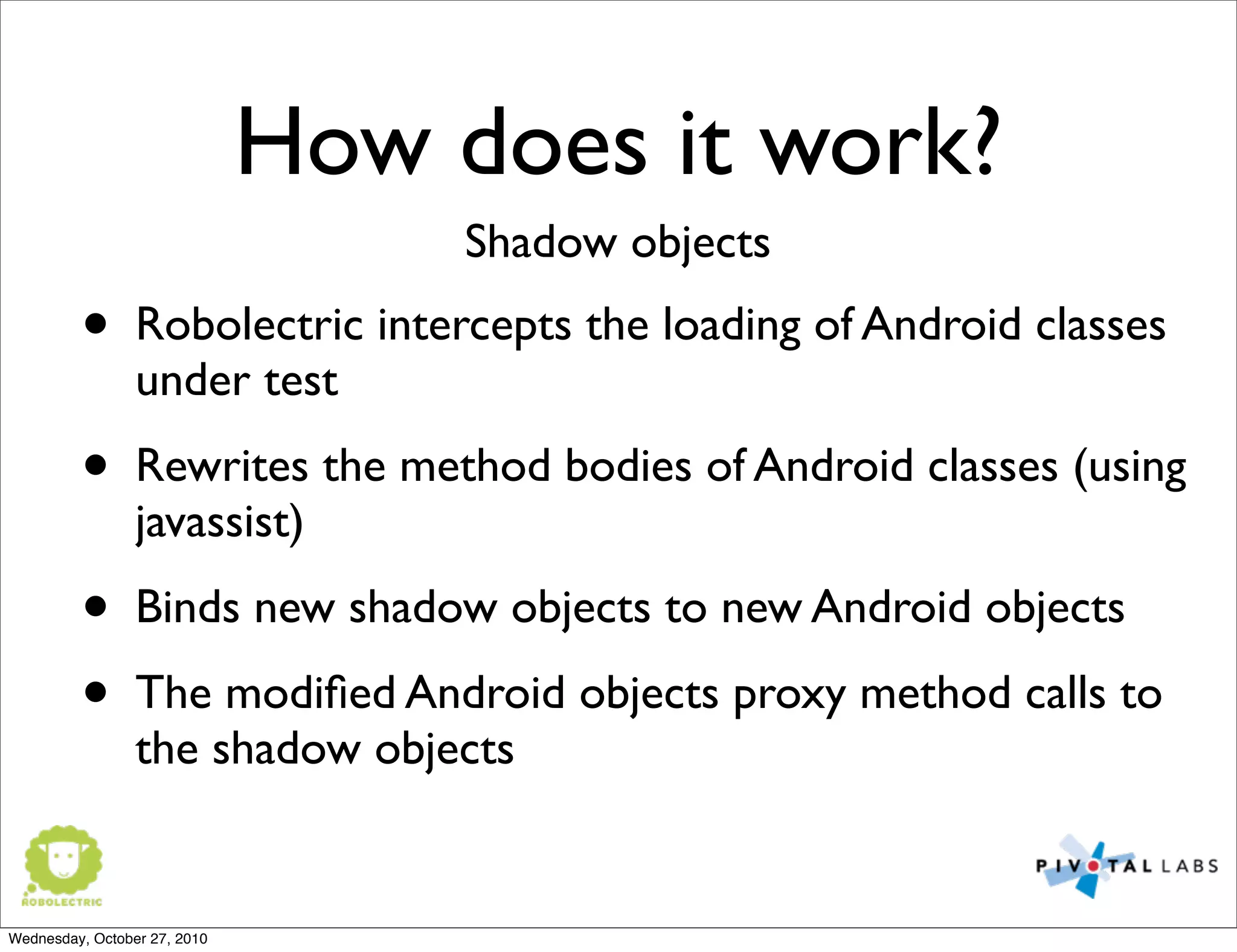

How does it work?
• Robolectric intercepts the loading of Android classes
under test
• Rewrites the method bodies of Android classes (using
javassist)
• Binds new shadow objects to new Android objects
• The modified Android objects proxy method calls to
the shadow objects
Shadow objects
Wednesday, October 27, 2010

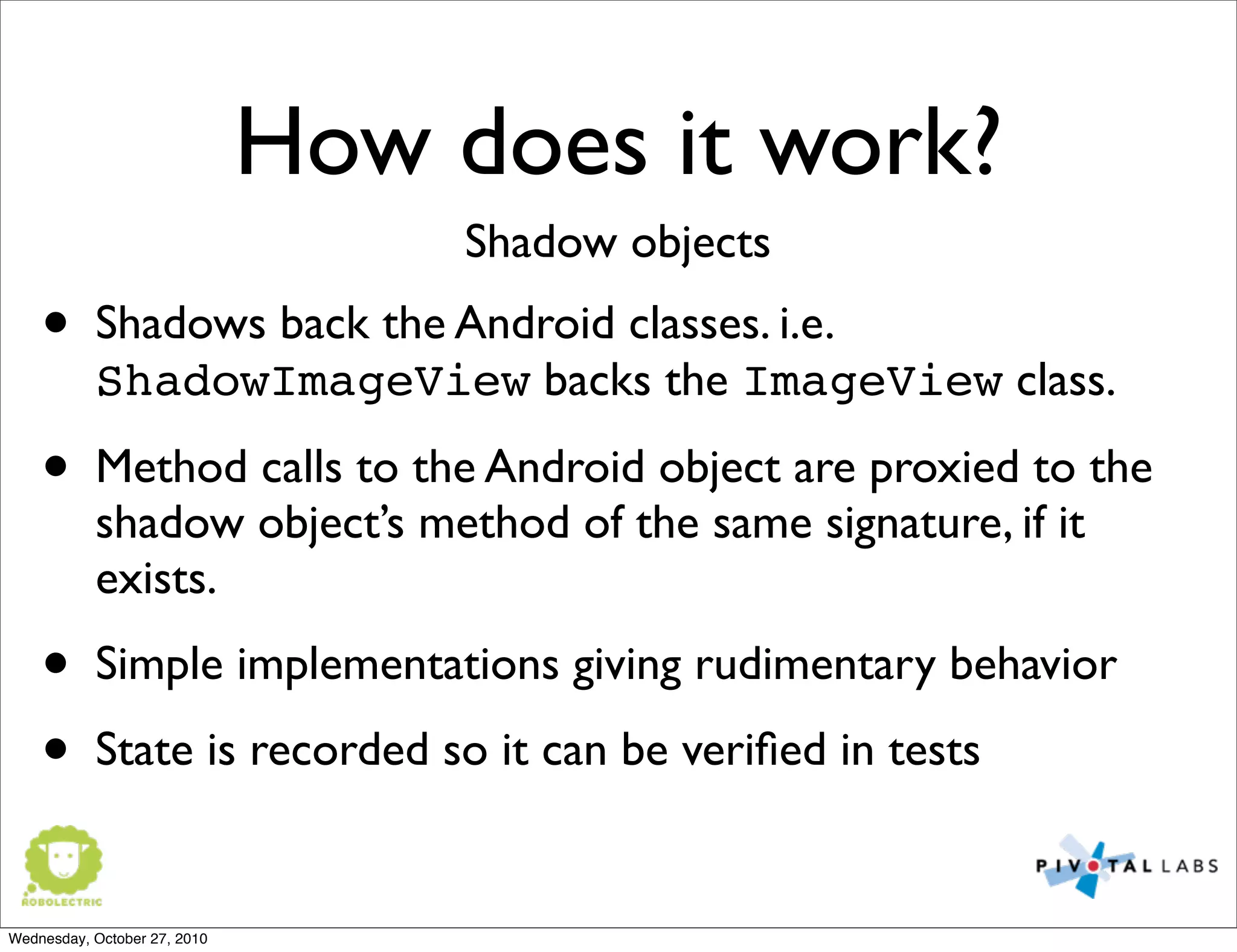

How does it work?
• Shadows back the Android classes. i.e.
ShadowImageView backs the ImageView class.
• Method calls to the Android object are proxied to the
shadow object’s method of the same signature, if it
exists.
• Simple implementations giving rudimentary behavior
• State is recorded so it can be verified in tests
Shadow objects
Wednesday, October 27, 2010

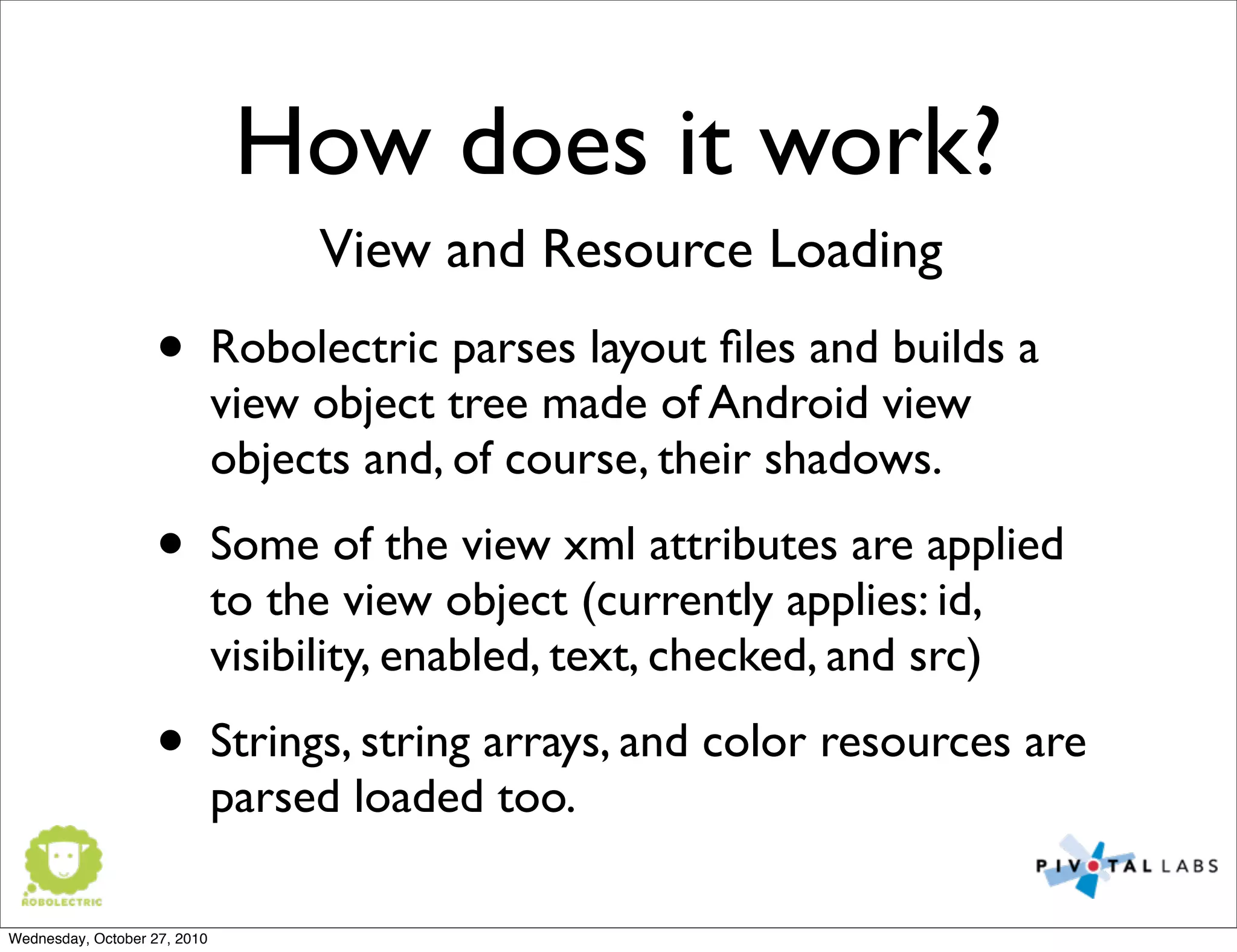

How does it work?
• Robolectric parses layout files and builds a
view object tree made of Android view
objects and, of course, their shadows.
• Some of the view xml attributes are applied
to the view object (currently applies: id,
visibility, enabled, text, checked, and src)
• Strings, string arrays, and color resources are
parsed loaded too.
View and Resource Loading

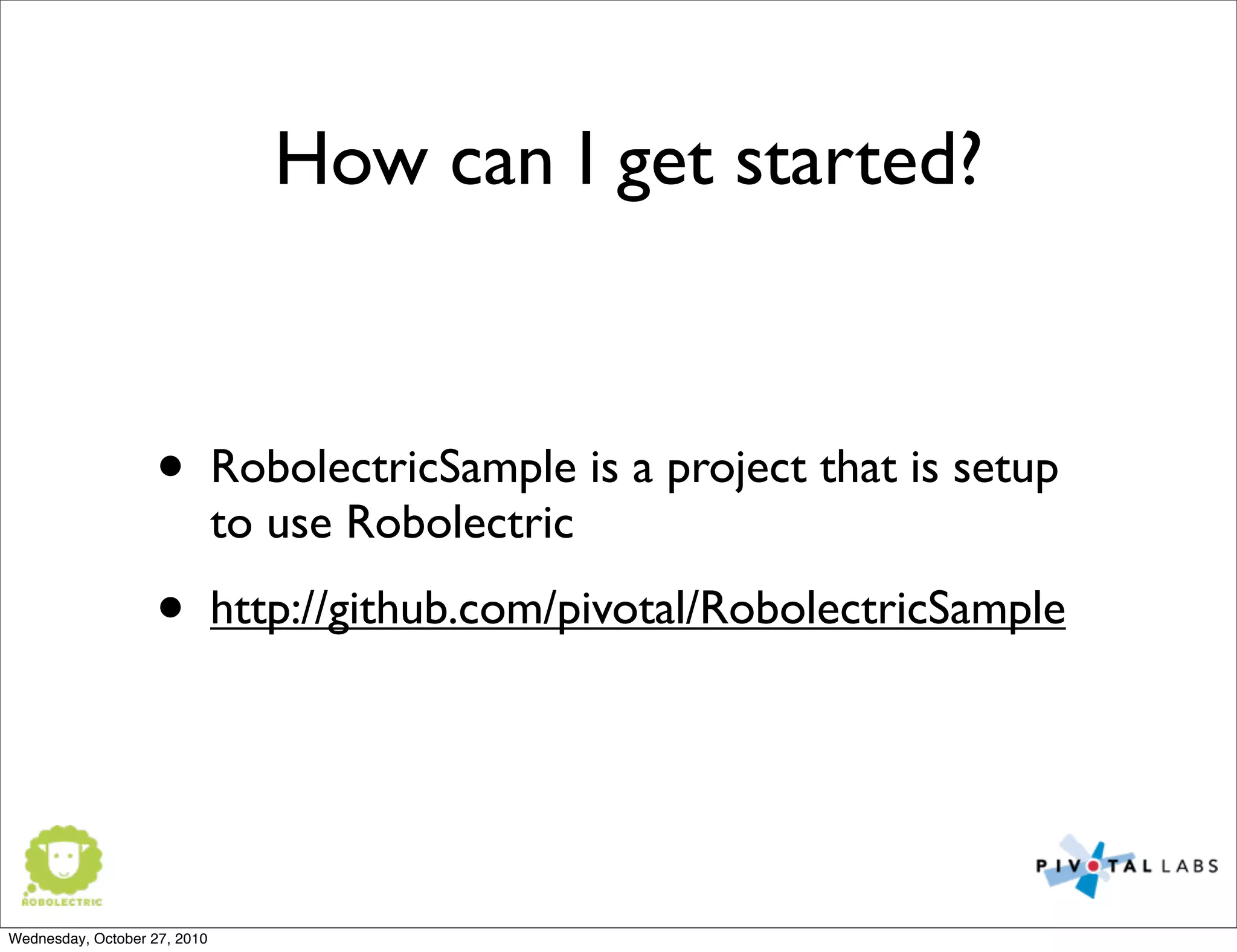

Wednesday, October 27, 2010
• RobolectricSample is a project that is setup
to use Robolectric
• http://github.com/pivotal/RobolectricSample
How can I get started?
Wednesday, October 27, 2010

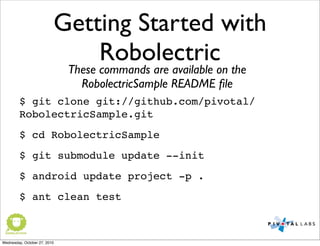

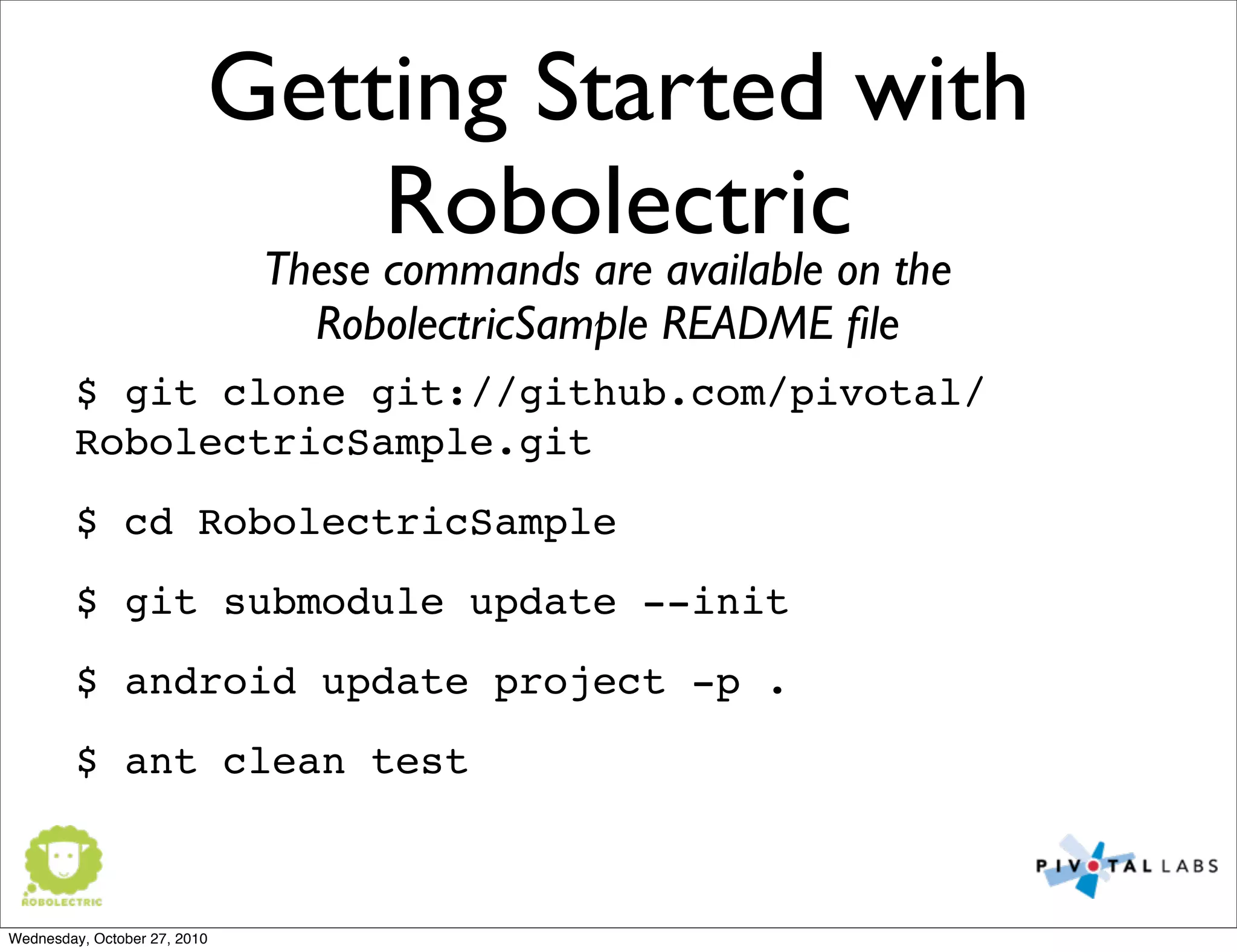

Getting Started with
Robolectric
$ git clone git://github.com/pivotal/
RobolectricSample.git
$ cd RobolectricSample
$ git submodule update --init
$ android update project -p .
$ ant clean test
These commands are available on the
RobolectricSample README file
Wednesday, October 27, 2010

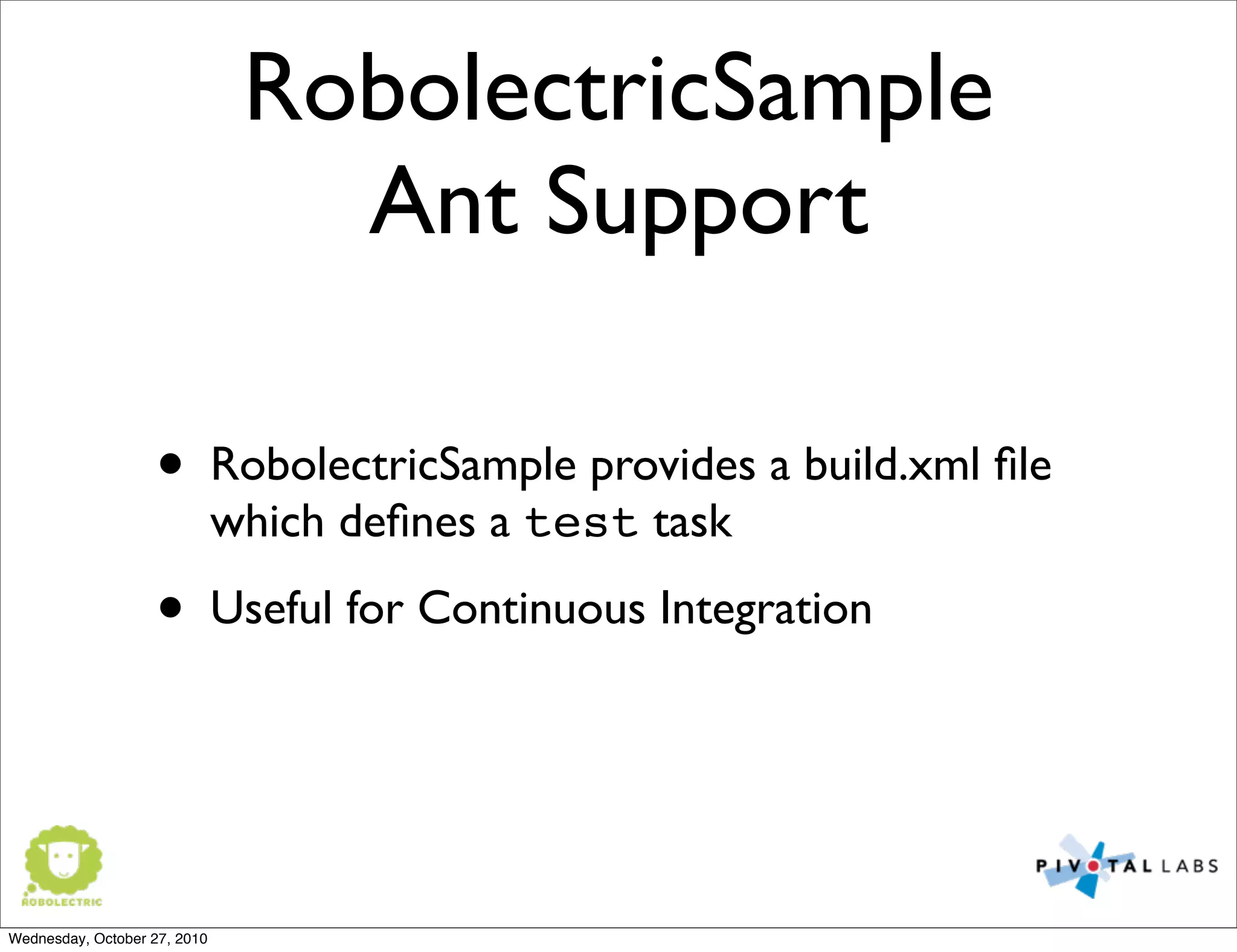

RobolectricSample
Ant Support
• RobolectricSample provides a build.xml file
which defines a test task
• Useful for Continuous Integration
Wednesday, October 27, 2010

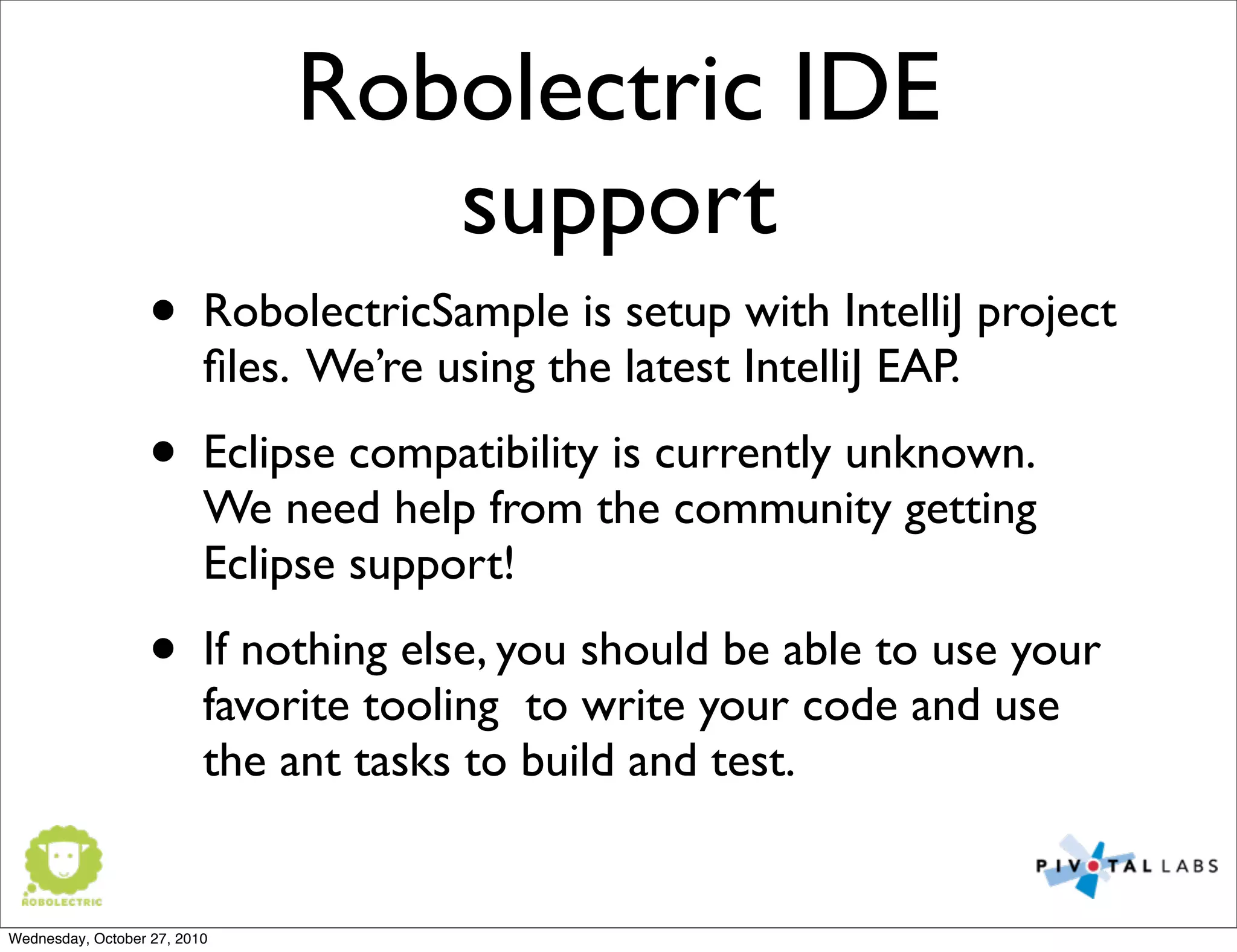

Robolectric IDE
support
• RobolectricSample is setup with IntelliJ project
files. We’re using the latest IntelliJ EAP.
• Eclipse compatibility is currently unknown.
We need help from the community getting
Eclipse support!
• If nothing else, you should be able to use your
favorite tooling to write your code and use
the ant tasks to build and test.
Wednesday, October 27, 2010

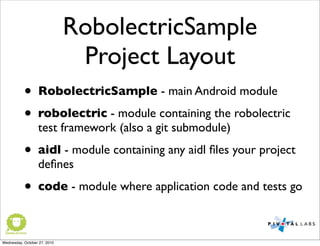

RobolectricSample

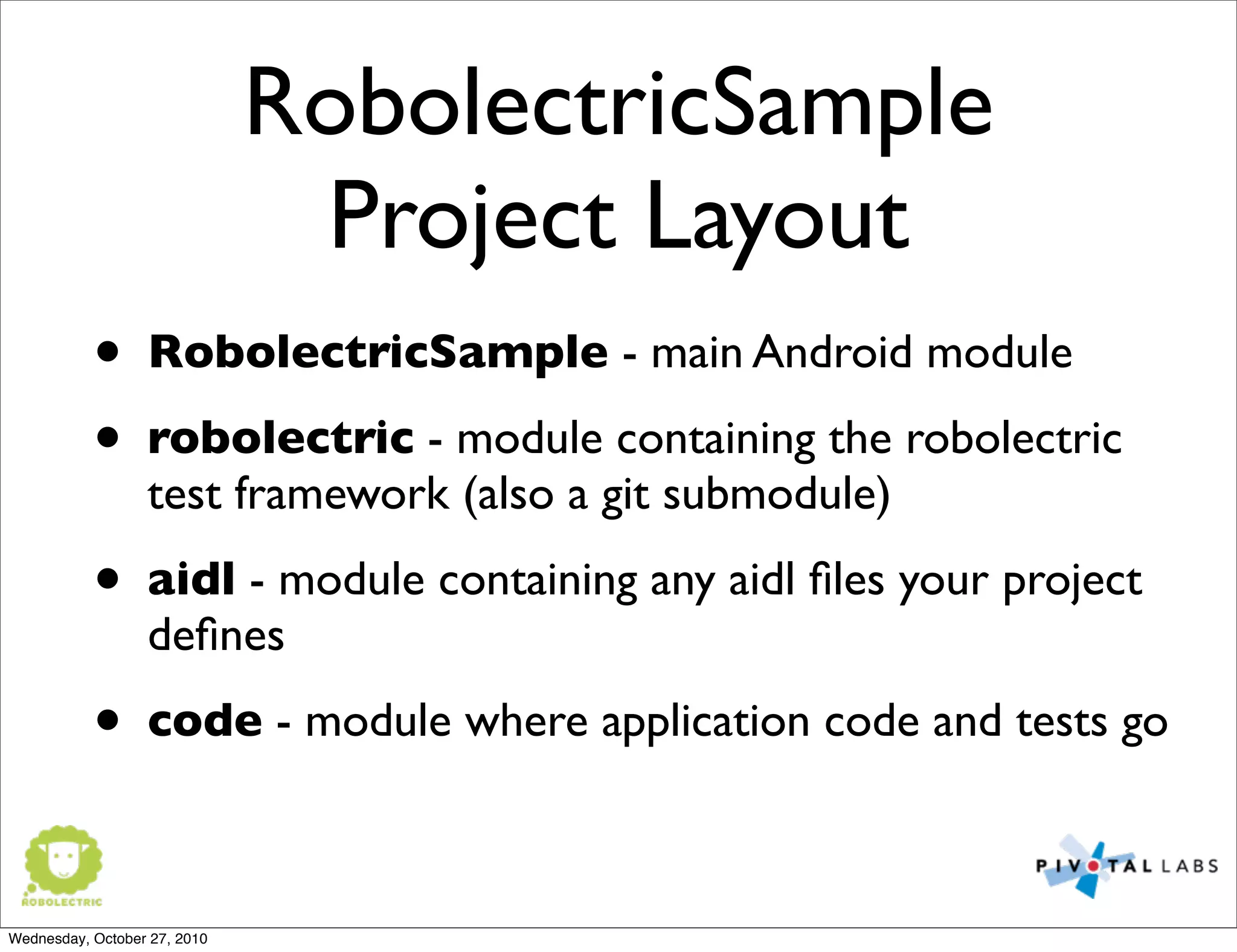

Project Layout
• RobolectricSample - main Android module
• robolectric - module containing the robolectric
test framework (also a git submodule)
• aidl - module containing any aidl files your project
defines
• code - module where application code and tests go
Wednesday, October 27, 2010

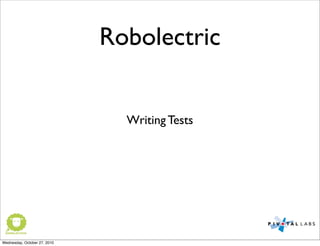

Robolectric
Writing Tests
Wednesday, October 27, 2010

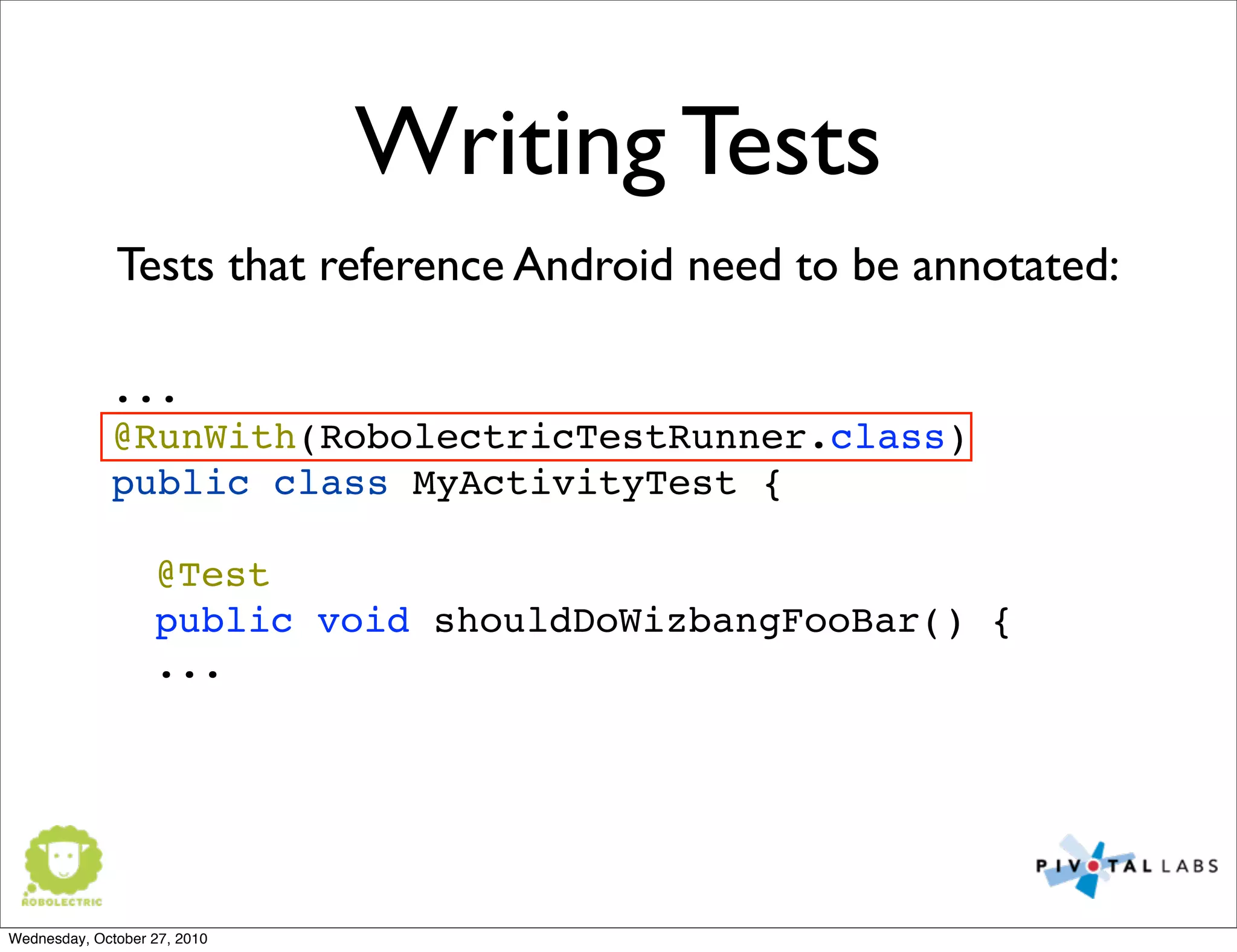

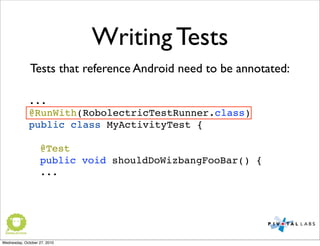

Writing Tests
...
@RunWith(RobolectricTestRunner.class)
public class MyActivityTest {
@Test
! public void shouldDoWizbangFooBar() {
...
Tests that reference Android need to be annotated:
Wednesday, October 27, 2010

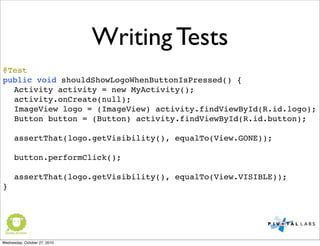

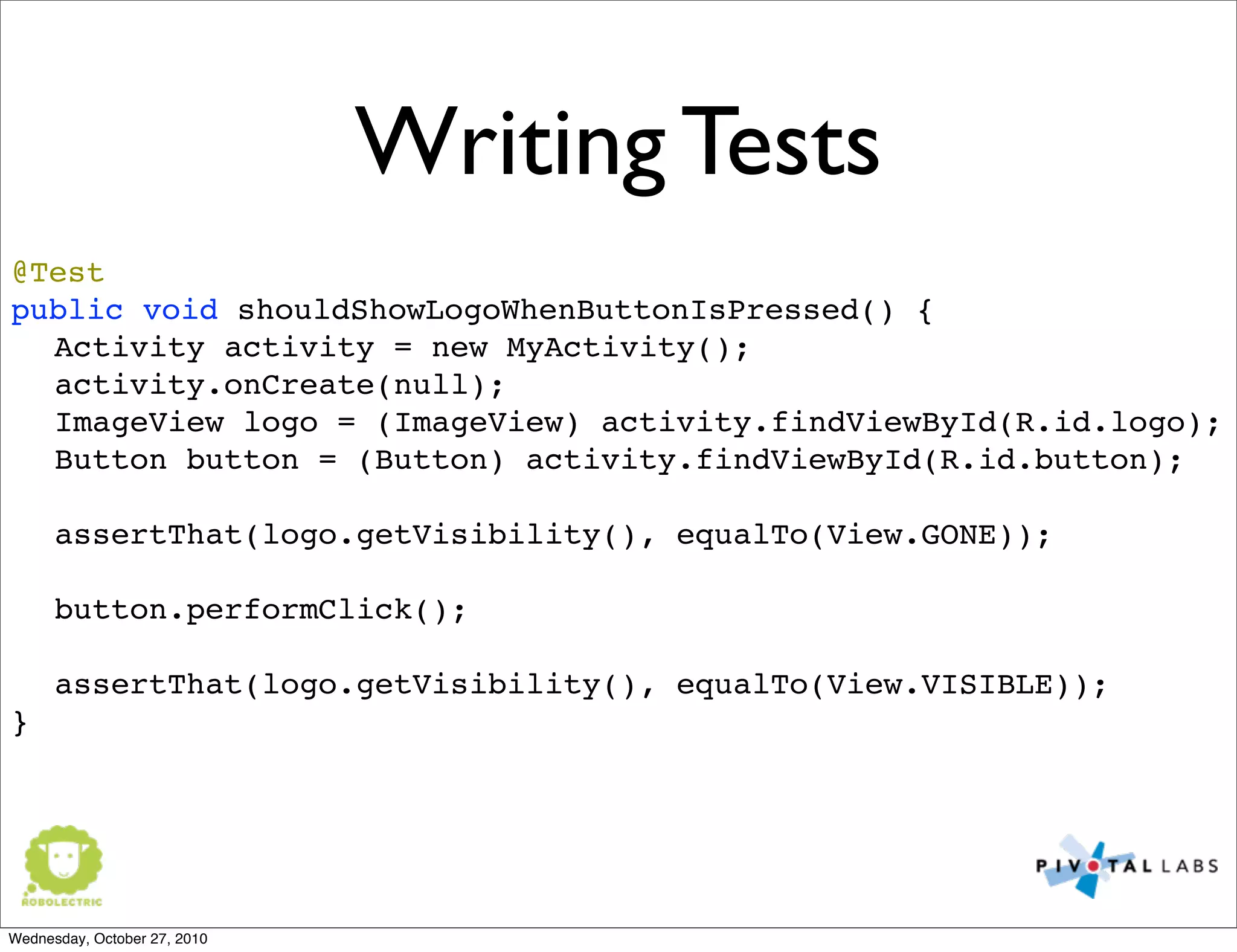

Writing Tests
@Test
public void shouldShowLogoWhenButtonIsPressed() {
Activity activity = new MyActivity();
activity.onCreate(null);
ImageView logo = (ImageView) activity.findViewById(R.id.logo);
Button button = (Button) activity.findViewById(R.id.button);
assertThat(logo.getVisibility(), equalTo(View.GONE));
button.performClick();
assertThat(logo.getVisibility(), equalTo(View.VISIBLE));
}
Wednesday, October 27, 2010

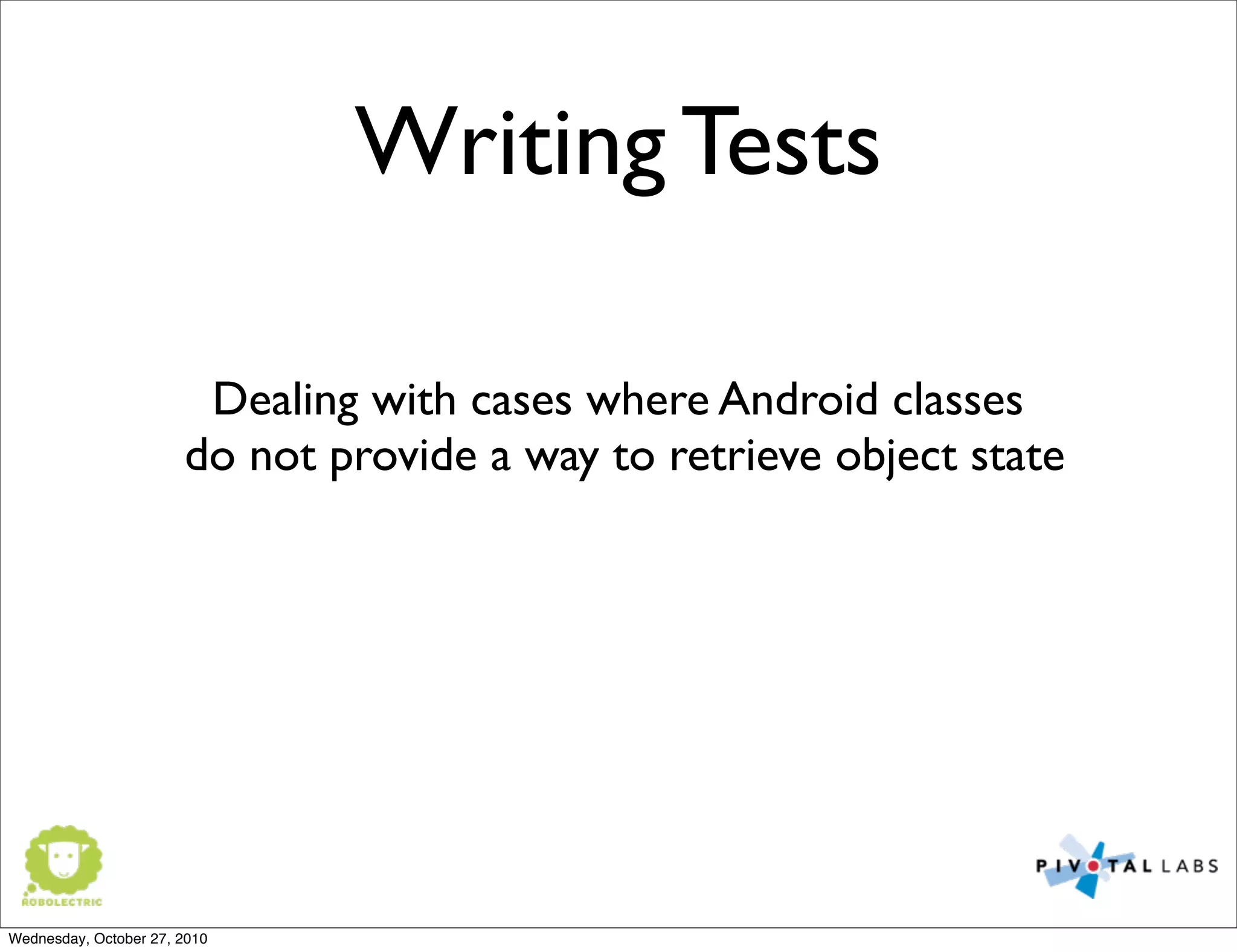

Writing Tests
Dealing with cases where Android classes
do not provide a way to retrieve object state
Wednesday, October 27, 2010

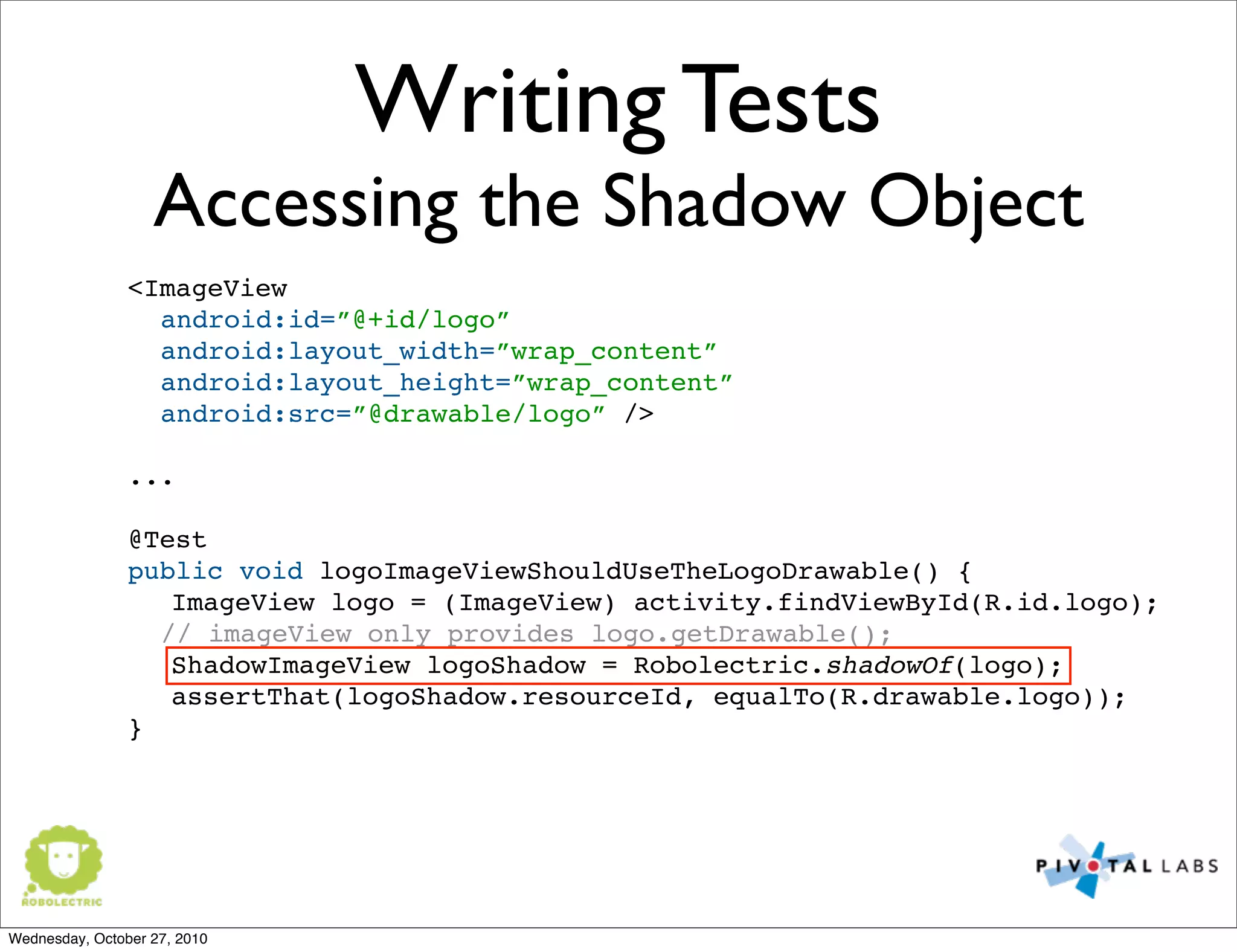

Writing Tests
Accessing the Shadow Object
<ImageView
android:id=”@+id/logo”
android:layout_width=”wrap_content”
android:layout_height=”wrap_content”
android:src=”@drawable/logo” />
...
@Test
public void logoImageViewShouldUseTheLogoDrawable() {
ImageView logo = (ImageView) activity.findViewById(R.id.logo);
// imageView only provides logo.getDrawable();
ShadowImageView logoShadow = Robolectric.shadowOf(logo);
assertThat(logoShadow.resourceId, equalTo(R.drawable.logo));
}
Wednesday, October 27, 2010

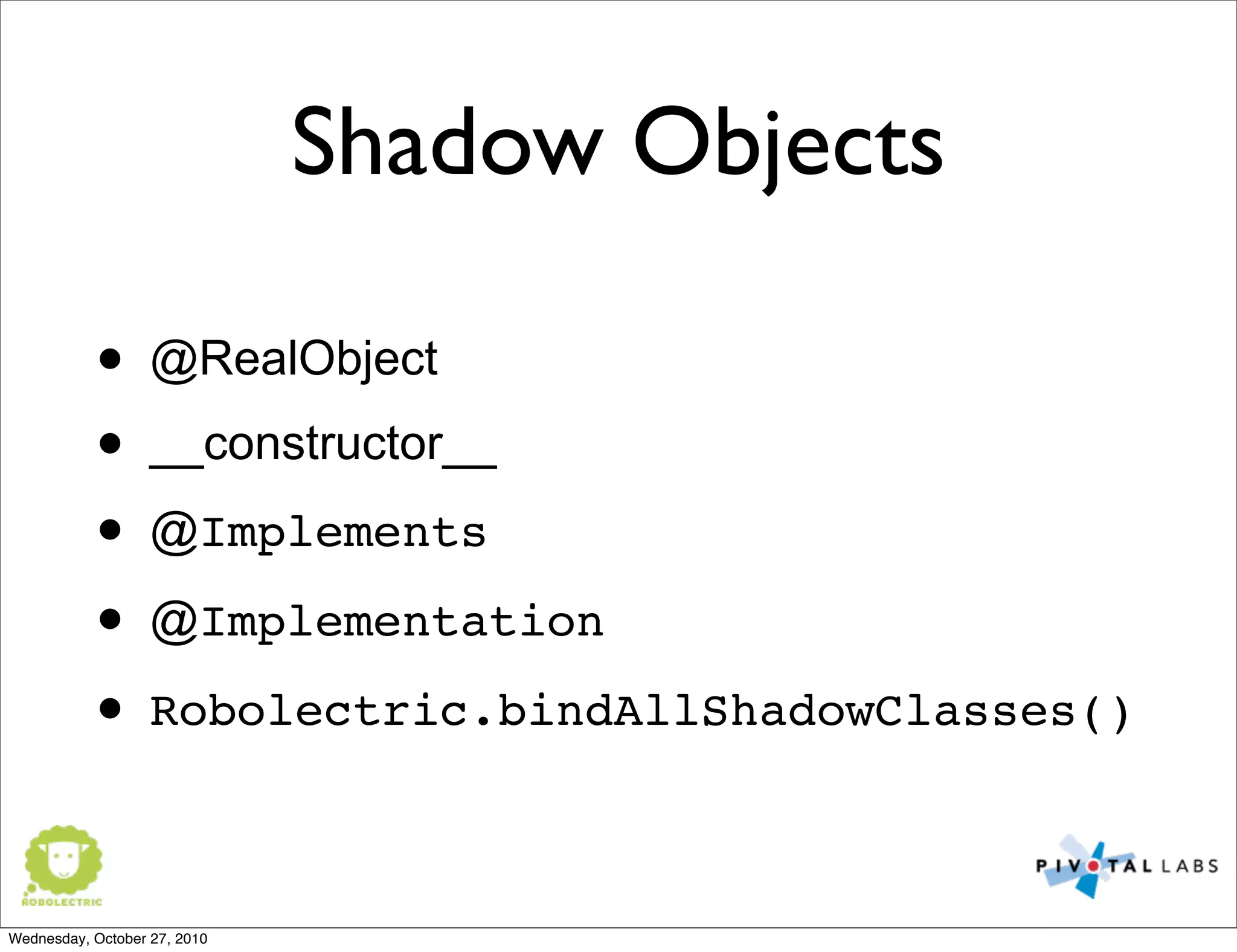

Shadow Objects
• @RealObject
• __constructor__
• @Implements
• @Implementation
• Robolectric.bindAllShadowClasses()
Wednesday, October 27, 2010
Shadow Objects

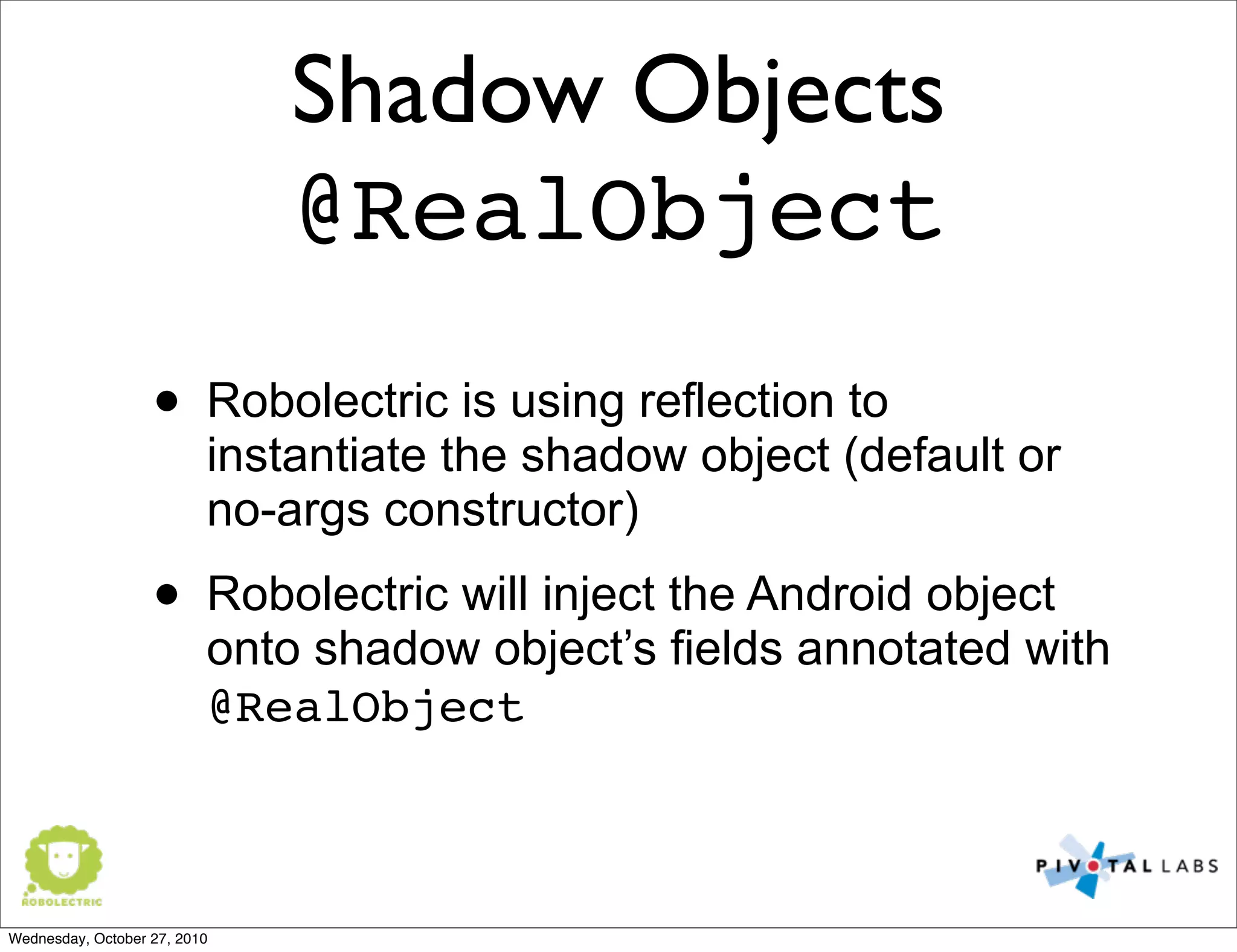

@RealObject
• Robolectric is using reflection to
instantiate the shadow object (default or
no-args constructor)
• Robolectric will inject the Android object
onto shadow object’s fields annotated with
@RealObject
Wednesday, October 27, 2010
Shadow Objects

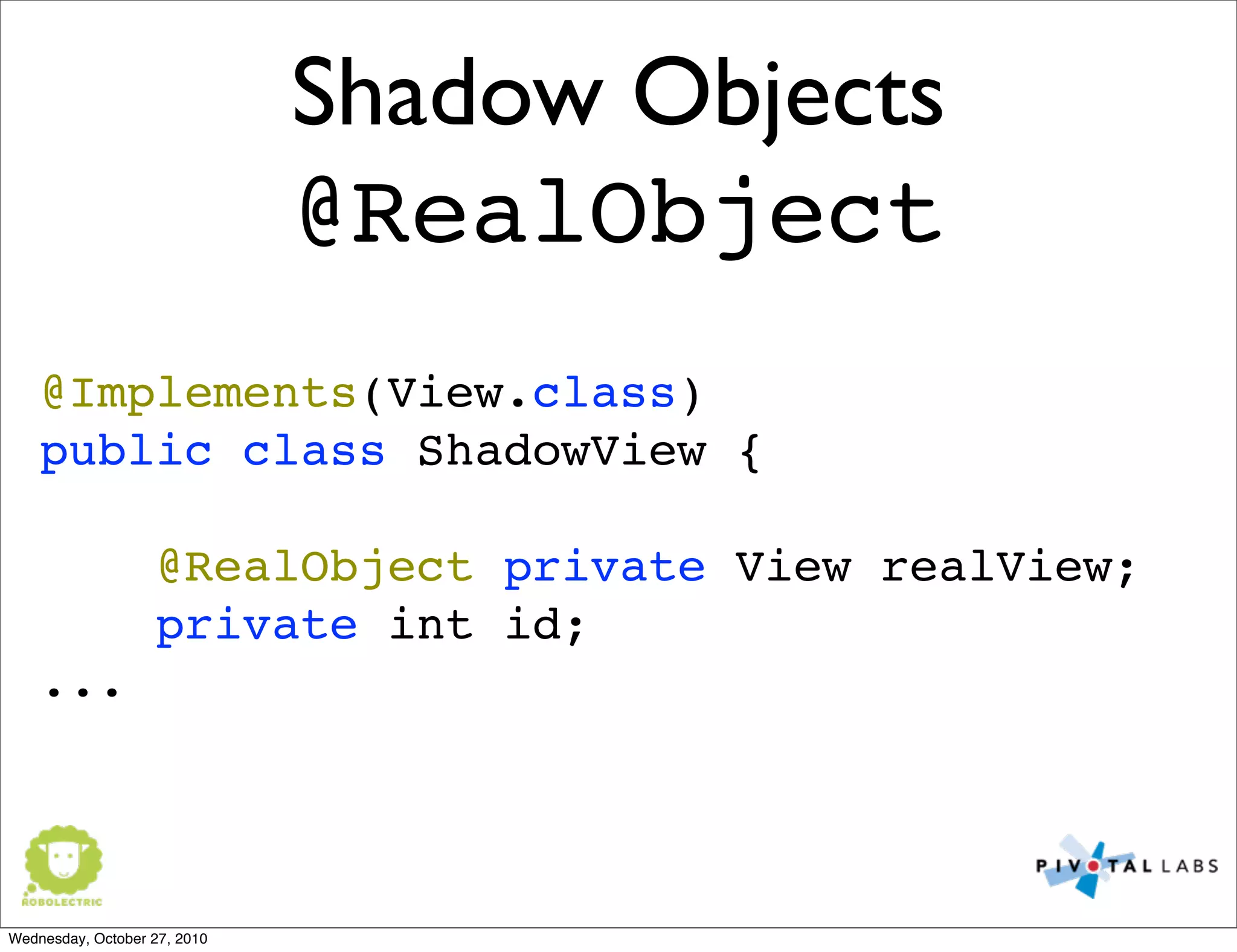

@RealObject
@Implements(View.class)
public class ShadowView {
@RealObject private View realView;
private int id;
...
Wednesday, October 27, 2010

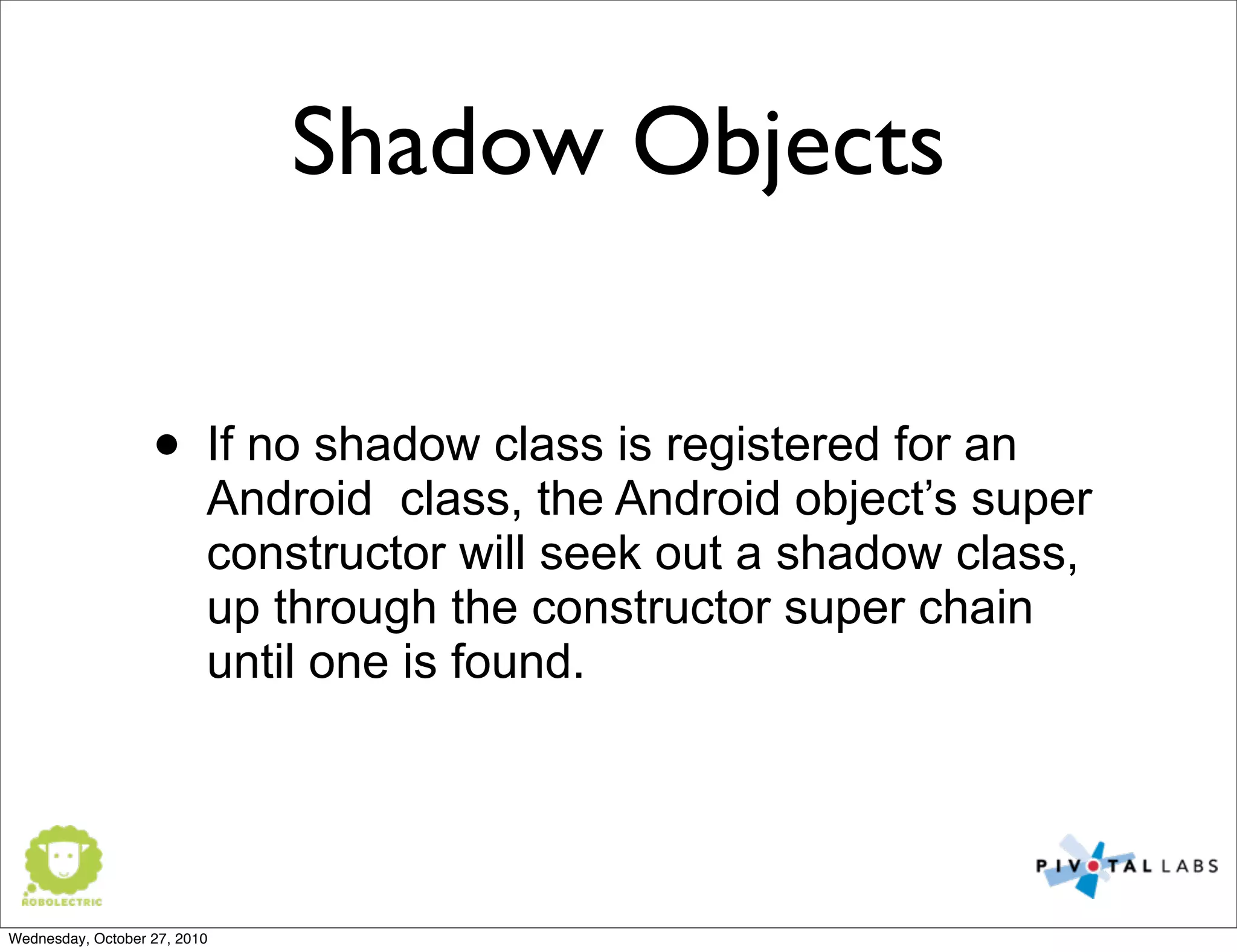

Shadow Objects
• If no shadow class is registered for an
Android class, the Android object’s super
constructor will seek out a shadow class,
up through the constructor super chain
until one is found.
Wednesday, October 27, 2010
Shadow Objects

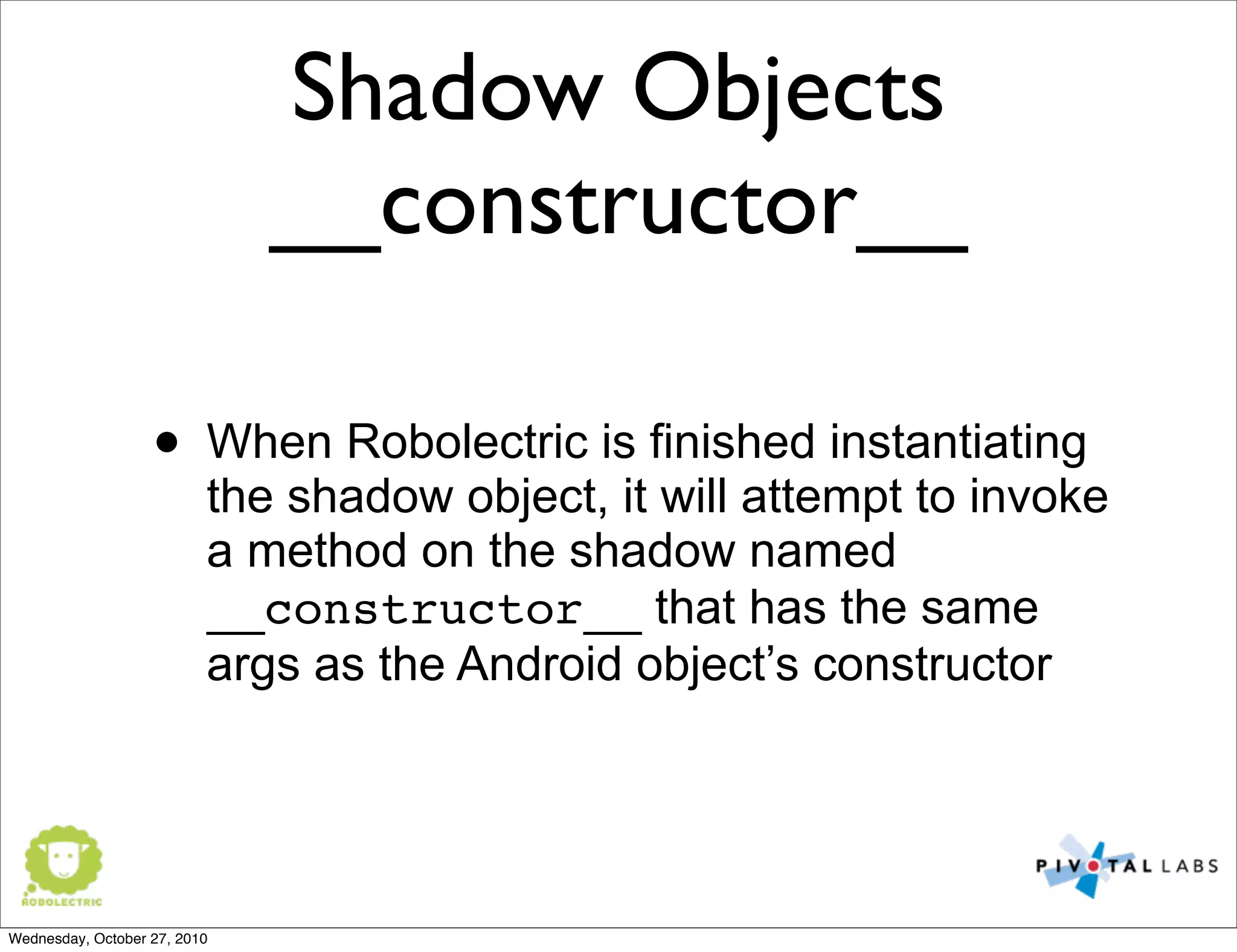

__constructor__
• When Robolectric is finished instantiating
the shadow object, it will attempt to invoke
a method on the shadow named
__constructor__ that has the same
args as the Android object’s constructor
Wednesday, October 27, 2010
Shadow Objects
__constructor__

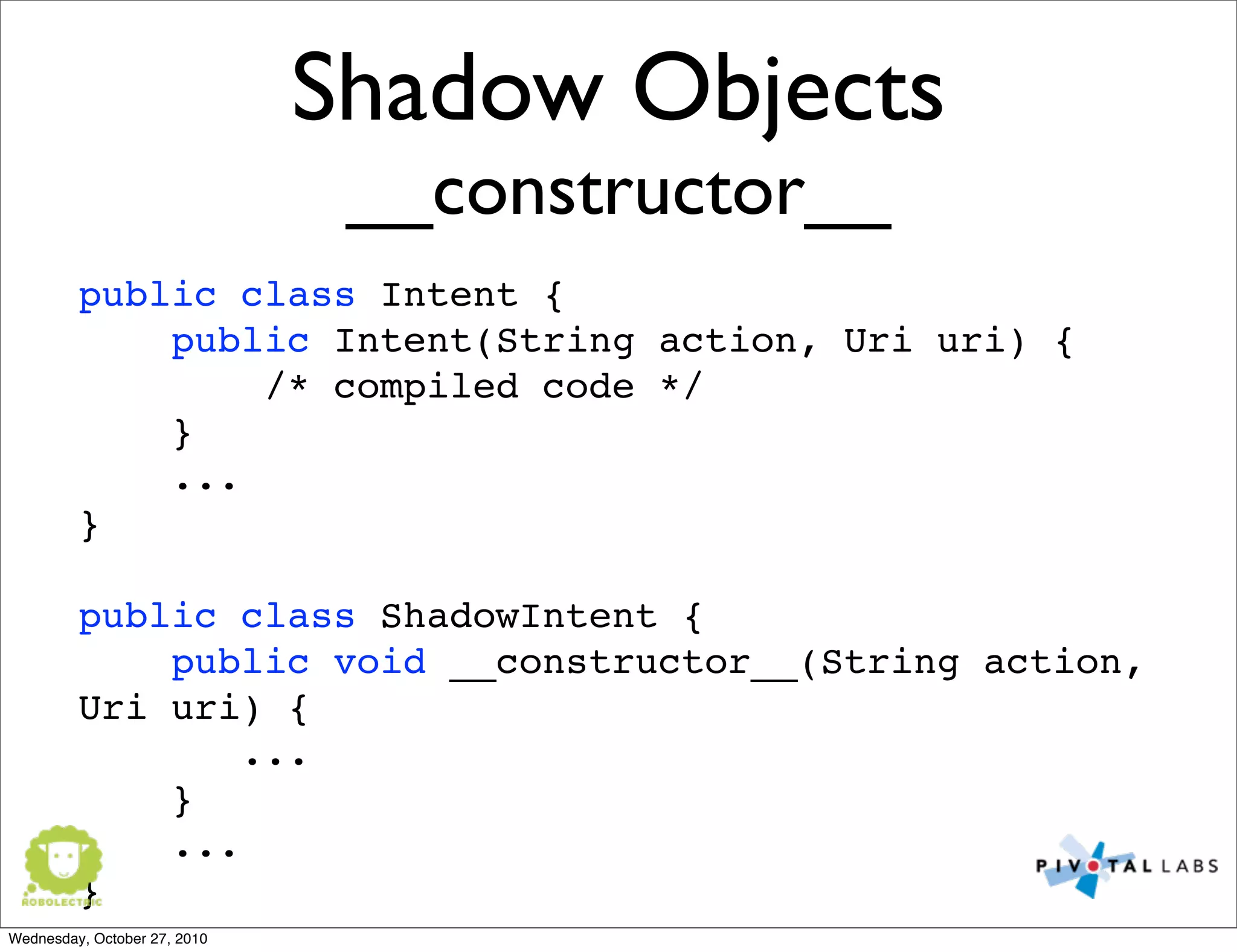

public class Intent {
public Intent(String action, Uri uri) {
/* compiled code */
}
...
}
public class ShadowIntent {
public void __constructor__(String action,
Uri uri) {
...
}
...
}
Wednesday, October 27, 2010

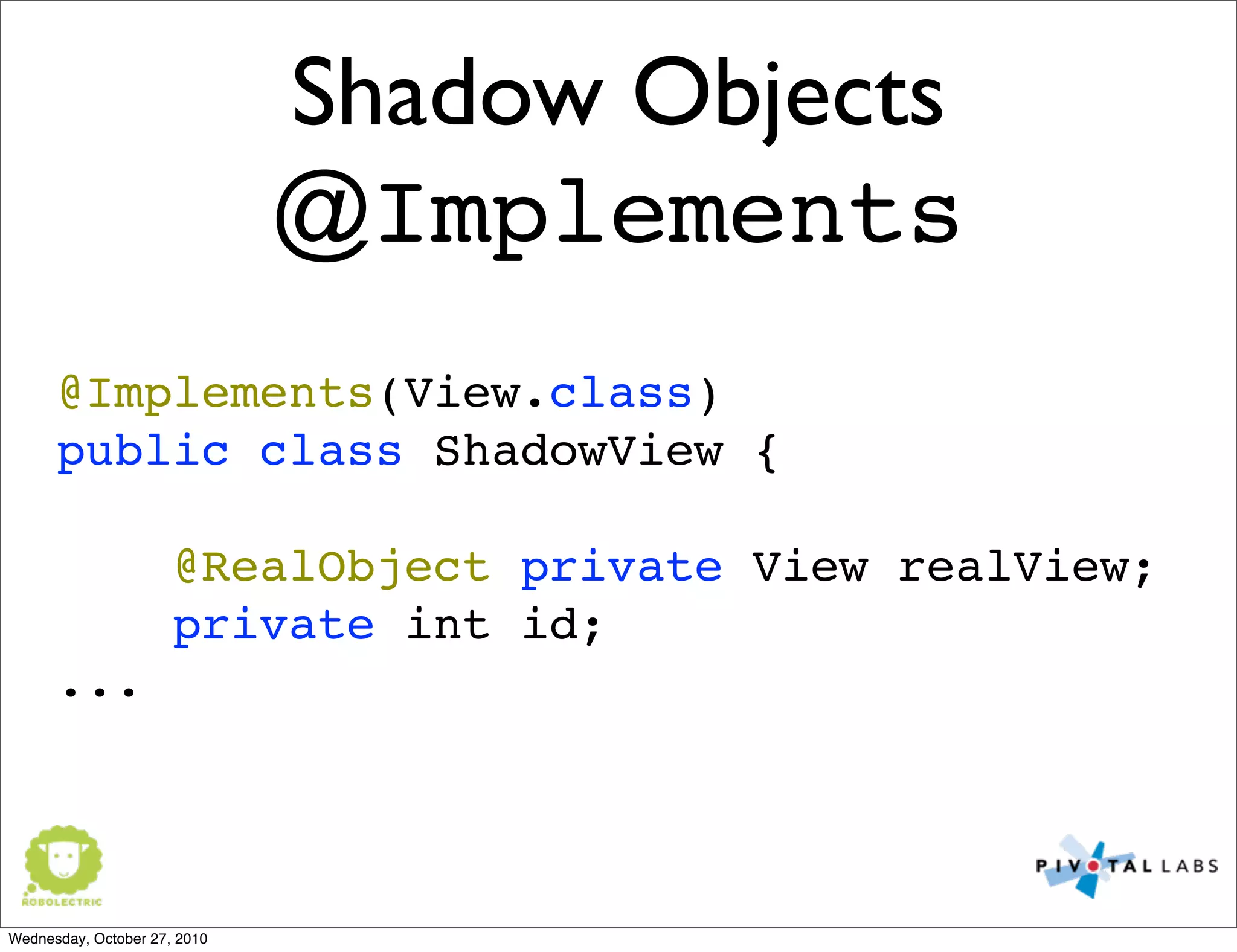

Shadow Objects

@Implements
@Implements(View.class)
public class ShadowView {
@RealObject private View realView;
private int id;
...
Wednesday, October 27, 2010

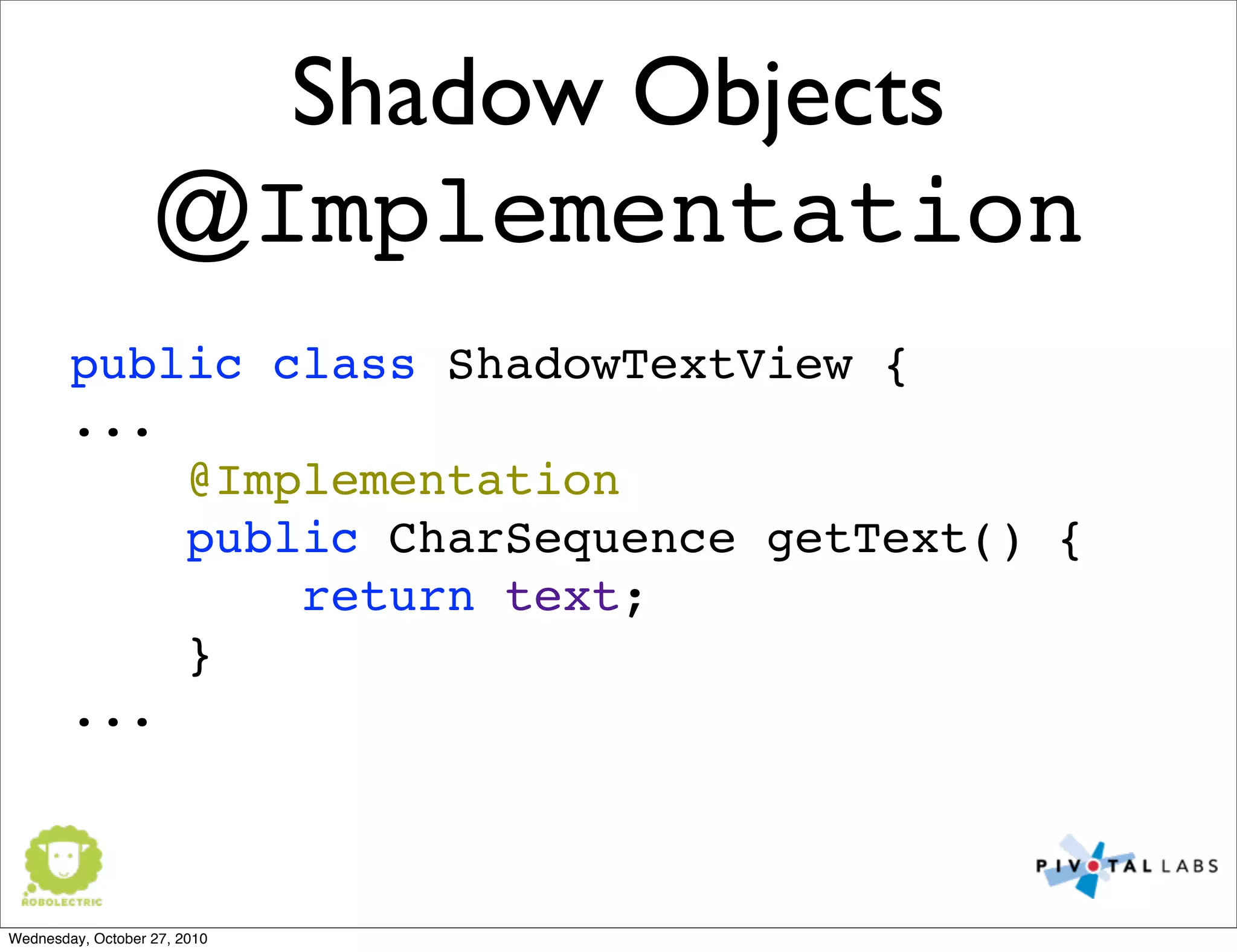

Shadow Objects
@Implementation
public class ShadowTextView {
...
@Implementation
public CharSequence getText() {
return text;
}
...
Wednesday, October 27, 2010
Shadow Objects

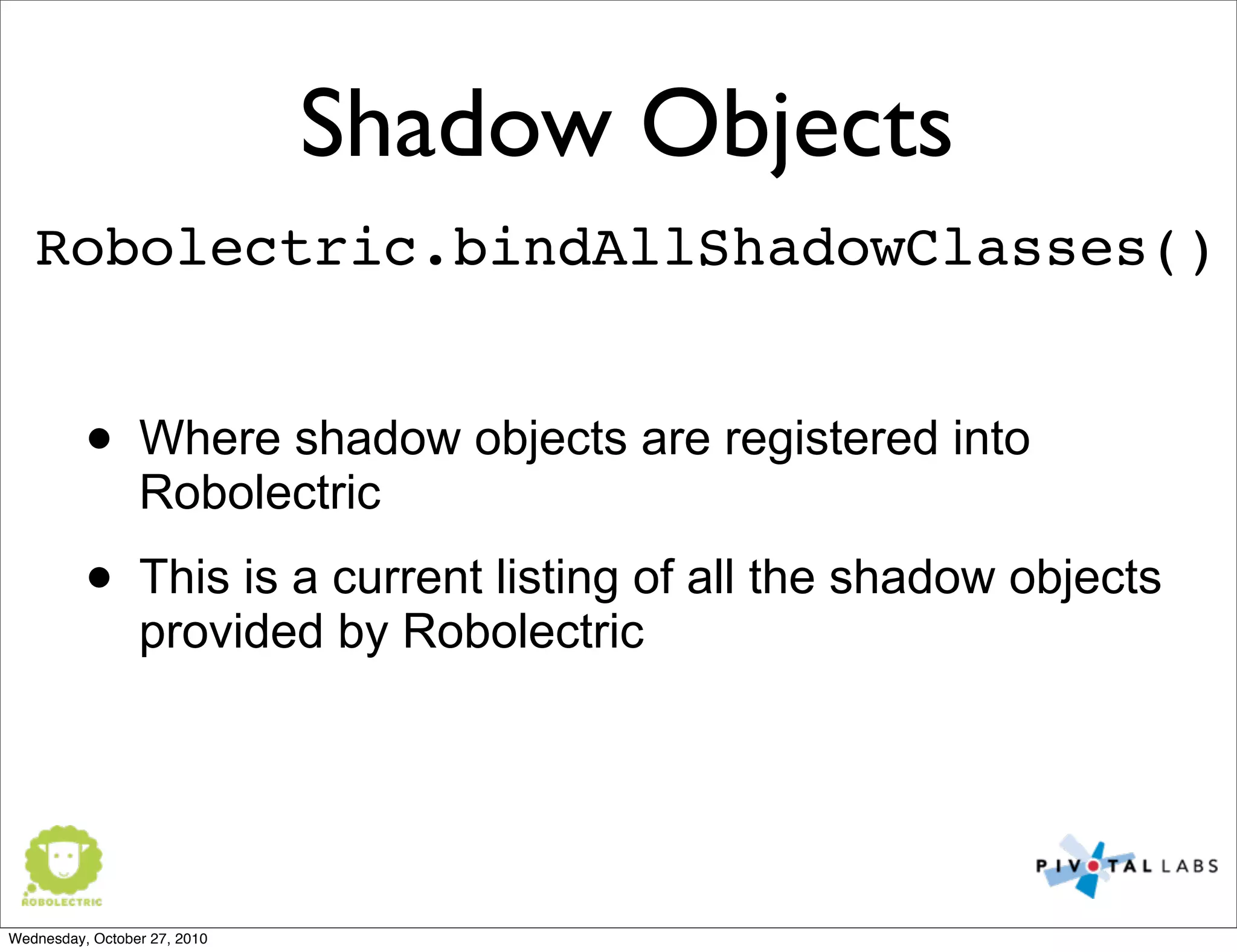

Robolectric.bindAllShadowClasses()
• Where shadow objects are registered into
Robolectric
• This is a current listing of all the shadow objects
provided by Robolectric
Wednesday, October 27, 2010

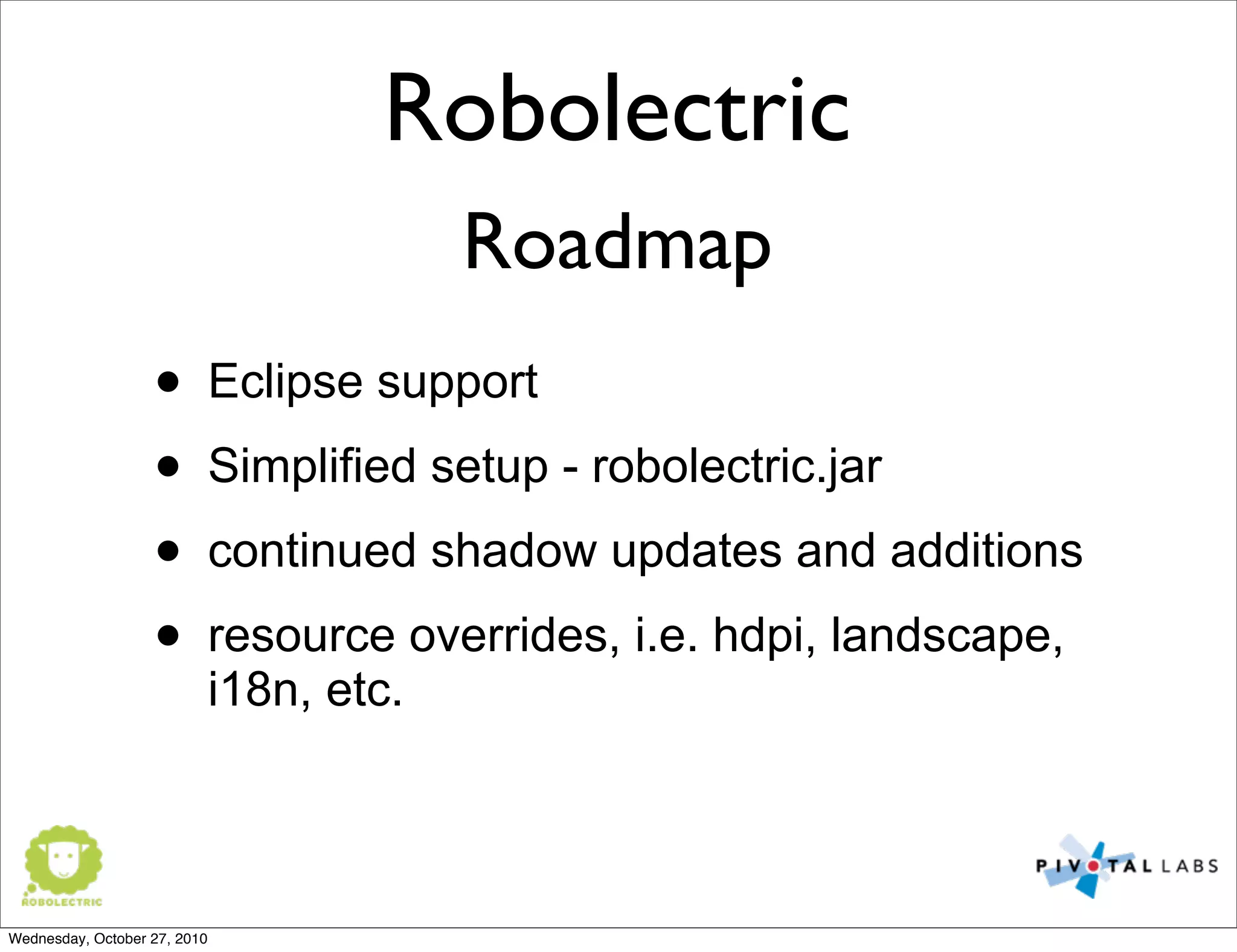

Robolectric

Roadmap
• Eclipse support
• Simplified setup - robolectric.jar
• continued shadow updates and additions
• resource overrides, i.e. hdpi, landscape,
i18n, etc.
Wednesday, October 27, 2010

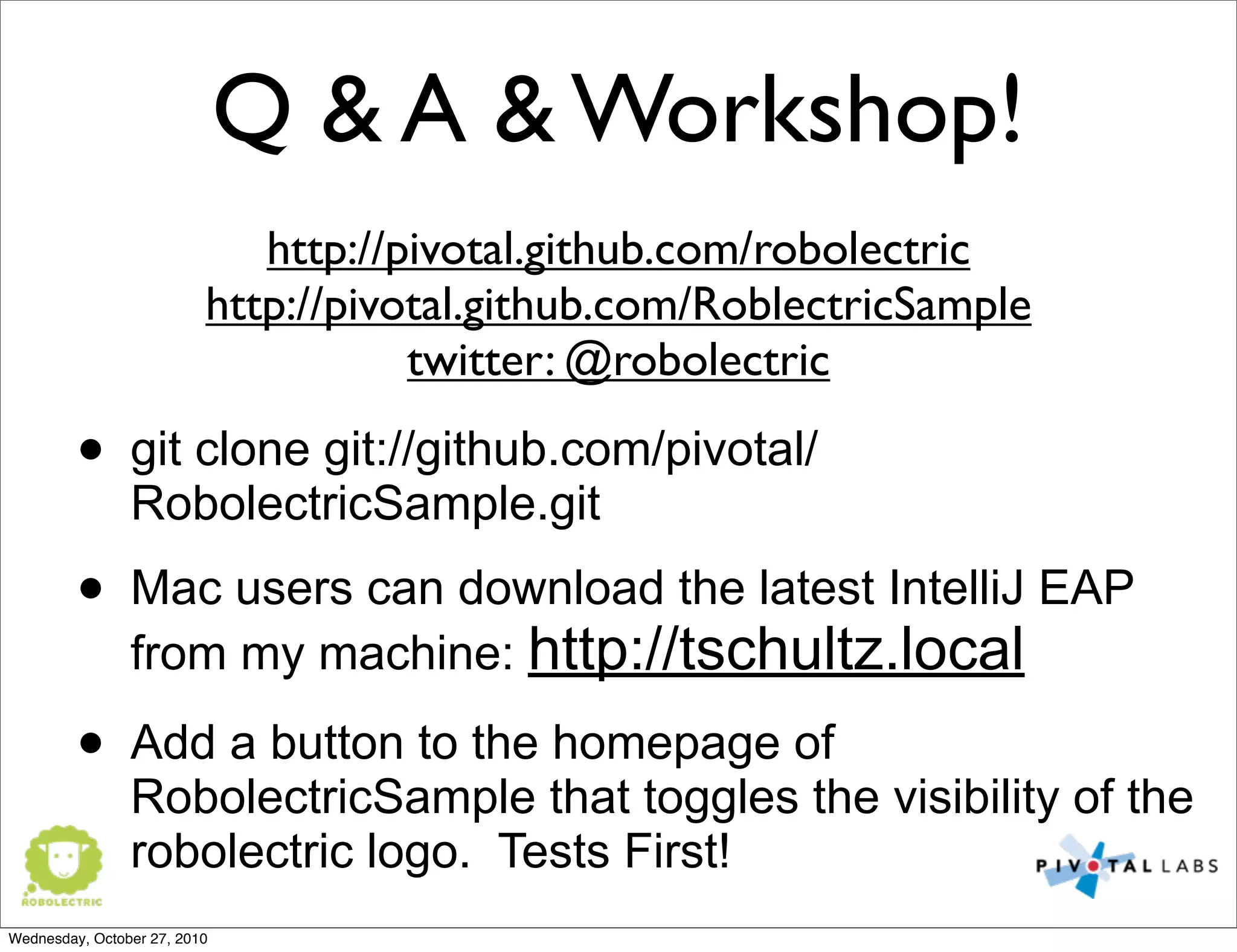

Q & A & Workshop!
• git clone git://github.com/pivotal/
RobolectricSample.git
• Mac users can download the latest IntelliJ EAP
from my machine: http://tschultz.local
• Add a button to the homepage of
RobolectricSample that toggles the visibility of the
robolectric logo. Tests First!
http://pivotal.github.com/robolectric
http://pivotal.github.com/RoblectricSample
twitter: @robolectric
Wednesday, October 27, 2010

Learn How to Unit Test Your Android Application (with Robolectric)

  • 1.
    Android Unit TestFramework http://pivotal.github.com/robolectric Follow us on twitter: @robolectric Wednesday, October 27, 2010
  • 2.
    Tyler Schultz Agile Engineer,Pivotal Labs Wednesday, October 27, 2010
  • 3.
    Talking Points • TestingApproaches and Alternatives • How Robolectric works • How to extend Robolectric • Workshop - write tests & help getting you setup Wednesday, October 27, 2010
  • 4.
    Pivotal Labs • Jasmine- Javascript BDD test framework, @jasminebdd • Cedar - iOS/Objective-C BDD test framework, @cedarbdd • Pivotal Tracker - www.pivotaltracker.com You may have heard of us: Wednesday, October 27, 2010
  • 5.
    Why Unit Test? Wednesday,October 27, 2010
  • 6.
    Pivotal Labs • www.pivotallabs.com •San Francisco (Headquarters), NewYork, Boulder, Singapore • Primarily Rails - we do mobile too! • Agile, XP, Continuos Integration, Pair Programming Wednesday, October 27, 2010
  • 7.
  • 8.
    Google has strippedthe classes in the android.jar file and have had all their method bodies replaced with: throw new RuntimeException(“Stub!”); Wednesday, October 27, 2010
  • 9.
    Additional Android testingchallenges • Many of the classes and methods are final • Lack of interfaces • Non public constructors • static methods Wednesday, October 27, 2010
  • 10.
    sfandroid.org members, whathave you been doing? Wednesday, October 27, 2010
  • 11.
  • 12.
    Android Testing Approaches • NoTests! EGAD! • Android InstrumentationTests/Robotium - integration style testing of Android apps • Library of tested POJO’s, referenced from a non tested Android project • Mocking framework such as Easy Mock and Mockito Wednesday, October 27, 2010
  • 13.
  • 14.
    Robolectric • Christian Williamswrote the core while working on projects at Xtreme Labs of Toronto.ThankYou Xtreme Labs! • Robolectric is published under the MIT license Wednesday, October 27, 2010
  • 15.
    Robolectric • Pivotal Labshas forked Xtreme Labs repo, renamed it to Robolectric, and expanded its functionality • We’ve used Robolectric on several projects with great success! Wednesday, October 27, 2010
  • 16.
    Robolectric Why use Robolectric? Whatmakes it so great? Wednesday, October 27, 2010
  • 17.
    Why Use Robolectric vs.AndroidInstrumentation Tests? • Tests Run outside of the emulator in a JVM, not the DalvikVM - Running in a DalvikVM requires dexing, packaging and installation on an emulator or device - slow! - Tests execute quickly in the JVM and execute slowly on the emulator Wednesday, October 27, 2010
  • 18.
    Why Use Robolectric vs.AndroidInstrumentation Tests? • Iterate quickly! • The latest Pivotal Android project is using Robolectric boasting 1,047 tests that run in 28 seconds! Wednesday, October 27, 2010
  • 19.
    Why Use Robolectric vs.POJO lib approach? • The POJO lib approach leads to code proliferation, interfaces with multiple implementations - code bloat! • Robolectric allows for vastly increased test coverage. Test ALL your code, not just non- Android code. Wednesday, October 27, 2010
  • 20.
    • Mocking frameworkscan lead to tests that are reverse implementation of the code • Can lead to tests that are hard to read • Can lead to tests that don’t help refactoring Why use Robolectric vs. Mock approach? Wednesday, October 27, 2010
  • 21.
    Why Use Robolectric? •Iterate quickly • Robolectric allows for a black box style of testing • Test behavior instead of implementation • High test coverage Wednesday, October 27, 2010
  • 22.
    How does itwork? Google has stripped the classes in the android.jar file and have had all their method bodies replaced with: throw new RuntimeException(“Stub!”); Wednesday, October 27, 2010
  • 23.
    How does itwork? • Shadow Objects • View and Resource Loading Wednesday, October 27, 2010
  • 24.
    How does itwork? • Robolectric intercepts the loading of Android classes under test • Rewrites the method bodies of Android classes (using javassist) • Binds new shadow objects to new Android objects • The modified Android objects proxy method calls to the shadow objects Shadow objects Wednesday, October 27, 2010
  • 25.
    How does itwork? • Shadows back the Android classes. i.e. ShadowImageView backs the ImageView class. • Method calls to the Android object are proxied to the shadow object’s method of the same signature, if it exists. • Simple implementations giving rudimentary behavior • State is recorded so it can be verified in tests Shadow objects Wednesday, October 27, 2010
  • 26.
    How does itwork? • Robolectric parses layout files and builds a view object tree made of Android view objects and, of course, their shadows. • Some of the view xml attributes are applied to the view object (currently applies: id, visibility, enabled, text, checked, and src) • Strings, string arrays, and color resources are parsed loaded too. View and Resource Loading Wednesday, October 27, 2010
  • 27.
    • RobolectricSample isa project that is setup to use Robolectric • http://github.com/pivotal/RobolectricSample How can I get started? Wednesday, October 27, 2010
  • 28.
    Getting Started with Robolectric $git clone git://github.com/pivotal/ RobolectricSample.git $ cd RobolectricSample $ git submodule update --init $ android update project -p . $ ant clean test These commands are available on the RobolectricSample README file Wednesday, October 27, 2010
  • 29.
    RobolectricSample Ant Support • RobolectricSampleprovides a build.xml file which defines a test task • Useful for Continuous Integration Wednesday, October 27, 2010
  • 30.
    Robolectric IDE support • RobolectricSampleis setup with IntelliJ project files. We’re using the latest IntelliJ EAP. • Eclipse compatibility is currently unknown. We need help from the community getting Eclipse support! • If nothing else, you should be able to use your favorite tooling to write your code and use the ant tasks to build and test. Wednesday, October 27, 2010
  • 31.
    RobolectricSample Project Layout • RobolectricSample- main Android module • robolectric - module containing the robolectric test framework (also a git submodule) • aidl - module containing any aidl files your project defines • code - module where application code and tests go Wednesday, October 27, 2010
  • 32.
  • 33.
    Writing Tests ... @RunWith(RobolectricTestRunner.class) public classMyActivityTest { @Test ! public void shouldDoWizbangFooBar() { ... Tests that reference Android need to be annotated: Wednesday, October 27, 2010
  • 34.
    Writing Tests @Test public voidshouldShowLogoWhenButtonIsPressed() { Activity activity = new MyActivity(); activity.onCreate(null); ImageView logo = (ImageView) activity.findViewById(R.id.logo); Button button = (Button) activity.findViewById(R.id.button); assertThat(logo.getVisibility(), equalTo(View.GONE)); button.performClick(); assertThat(logo.getVisibility(), equalTo(View.VISIBLE)); } Wednesday, October 27, 2010
  • 35.
    Writing Tests Dealing withcases where Android classes do not provide a way to retrieve object state Wednesday, October 27, 2010
  • 36.
    Writing Tests Accessing theShadow Object <ImageView android:id=”@+id/logo” android:layout_width=”wrap_content” android:layout_height=”wrap_content” android:src=”@drawable/logo” /> ... @Test public void logoImageViewShouldUseTheLogoDrawable() { ImageView logo = (ImageView) activity.findViewById(R.id.logo); // imageView only provides logo.getDrawable(); ShadowImageView logoShadow = Robolectric.shadowOf(logo); assertThat(logoShadow.resourceId, equalTo(R.drawable.logo)); } Wednesday, October 27, 2010
  • 37.
    Shadow Objects • @RealObject •__constructor__ • @Implements • @Implementation • Robolectric.bindAllShadowClasses() Wednesday, October 27, 2010
  • 38.
    Shadow Objects @RealObject • Robolectricis using reflection to instantiate the shadow object (default or no-args constructor) • Robolectric will inject the Android object onto shadow object’s fields annotated with @RealObject Wednesday, October 27, 2010
  • 39.
    Shadow Objects @RealObject @Implements(View.class) public classShadowView { @RealObject private View realView; private int id; ... Wednesday, October 27, 2010
  • 40.
    Shadow Objects • Ifno shadow class is registered for an Android class, the Android object’s super constructor will seek out a shadow class, up through the constructor super chain until one is found. Wednesday, October 27, 2010
  • 41.
    Shadow Objects __constructor__ • WhenRobolectric is finished instantiating the shadow object, it will attempt to invoke a method on the shadow named __constructor__ that has the same args as the Android object’s constructor Wednesday, October 27, 2010
  • 42.

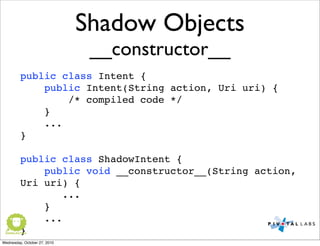

    Shadow Objects __constructor__ public classIntent { public Intent(String action, Uri uri) { /* compiled code */ } ... } public class ShadowIntent { public void __constructor__(String action, Uri uri) { ... } ... } Wednesday, October 27, 2010
  • 43.
    Shadow Objects @Implements @Implements(View.class) public classShadowView { @RealObject private View realView; private int id; ... Wednesday, October 27, 2010
  • 44.
    Shadow Objects @Implementation public classShadowTextView { ... @Implementation public CharSequence getText() { return text; } ... Wednesday, October 27, 2010
  • 45.

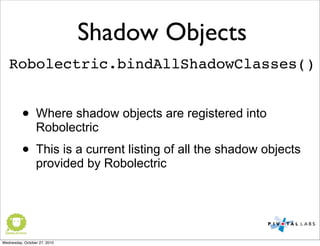

    Shadow Objects Robolectric.bindAllShadowClasses() • Whereshadow objects are registered into Robolectric • This is a current listing of all the shadow objects provided by Robolectric Wednesday, October 27, 2010
  • 46.
    Robolectric Roadmap • Eclipse support •Simplified setup - robolectric.jar • continued shadow updates and additions • resource overrides, i.e. hdpi, landscape, i18n, etc. Wednesday, October 27, 2010
  • 47.
    Q & A& Workshop! • git clone git://github.com/pivotal/ RobolectricSample.git • Mac users can download the latest IntelliJ EAP from my machine: http://tschultz.local • Add a button to the homepage of RobolectricSample that toggles the visibility of the robolectric logo. Tests First! http://pivotal.github.com/robolectric http://pivotal.github.com/RoblectricSample twitter: @robolectric Wednesday, October 27, 2010
