RISK MANAGEMENT
LIP SERVICE OR A PRACTICAL TOOL FOR
PROJECT SUCCESS
BY DR JOHN HOGAN PMP

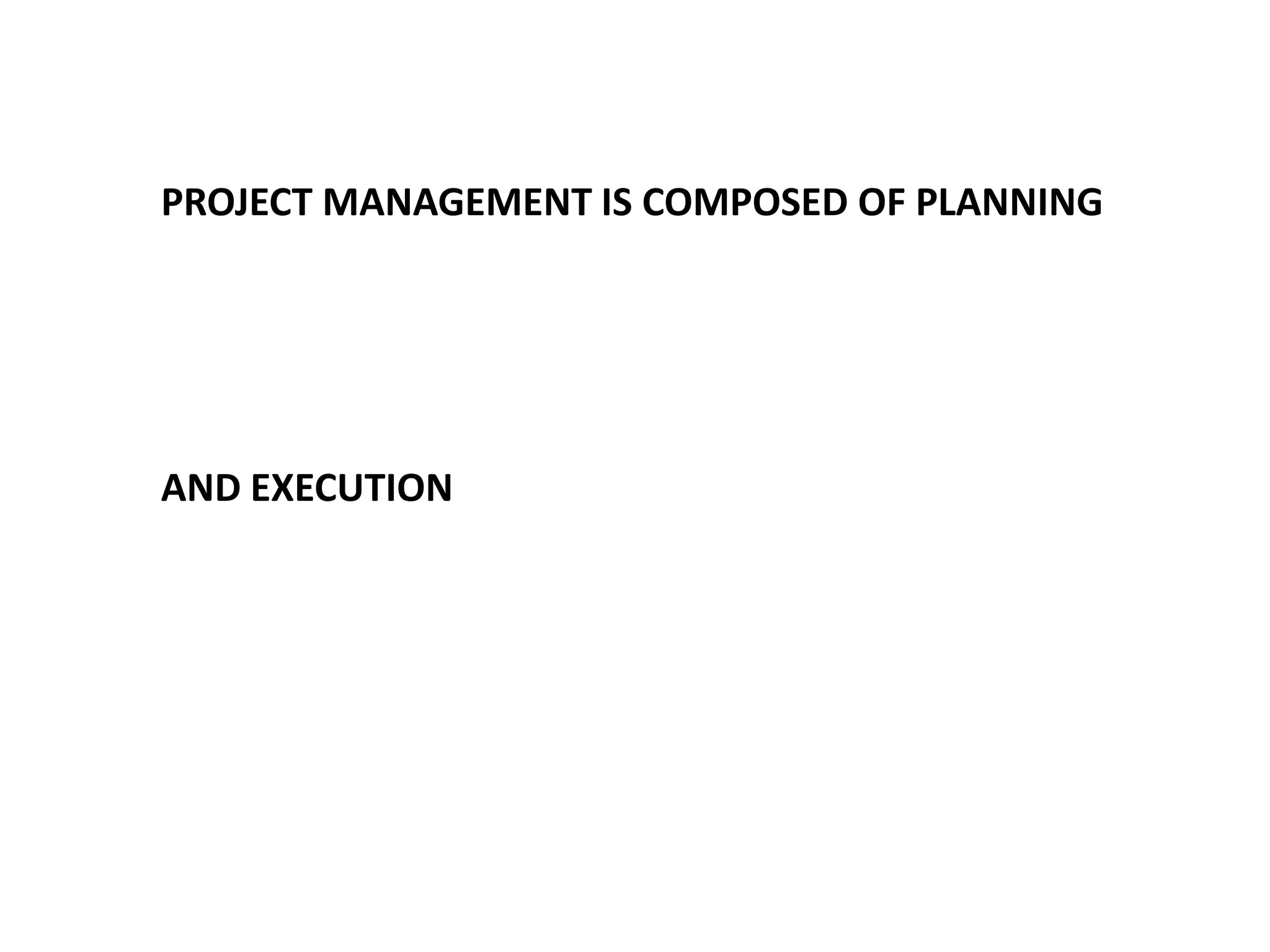

PROJECT MANAGEMENT IS COMPOSED OF PLANNING

AND EXECUTION

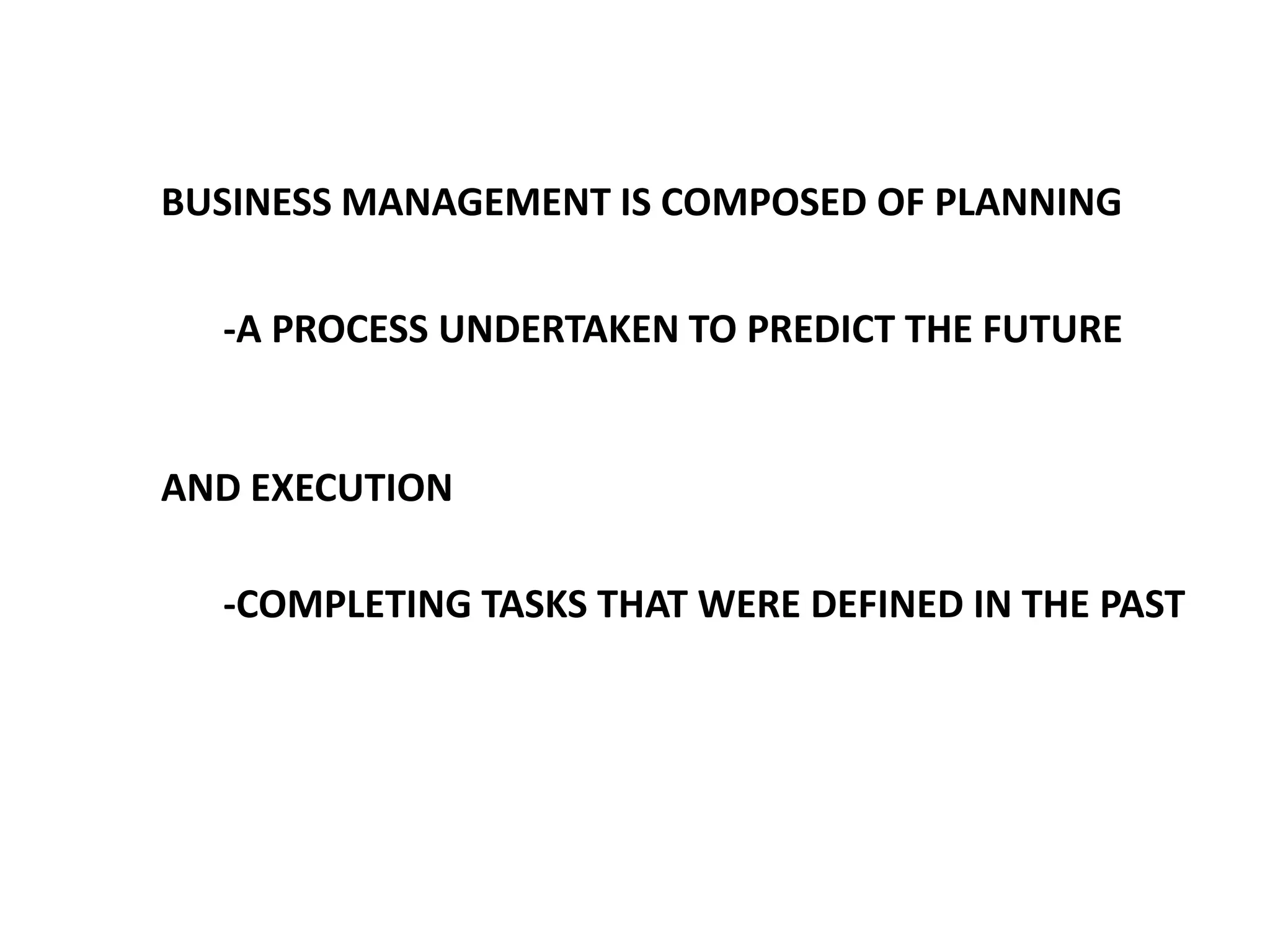

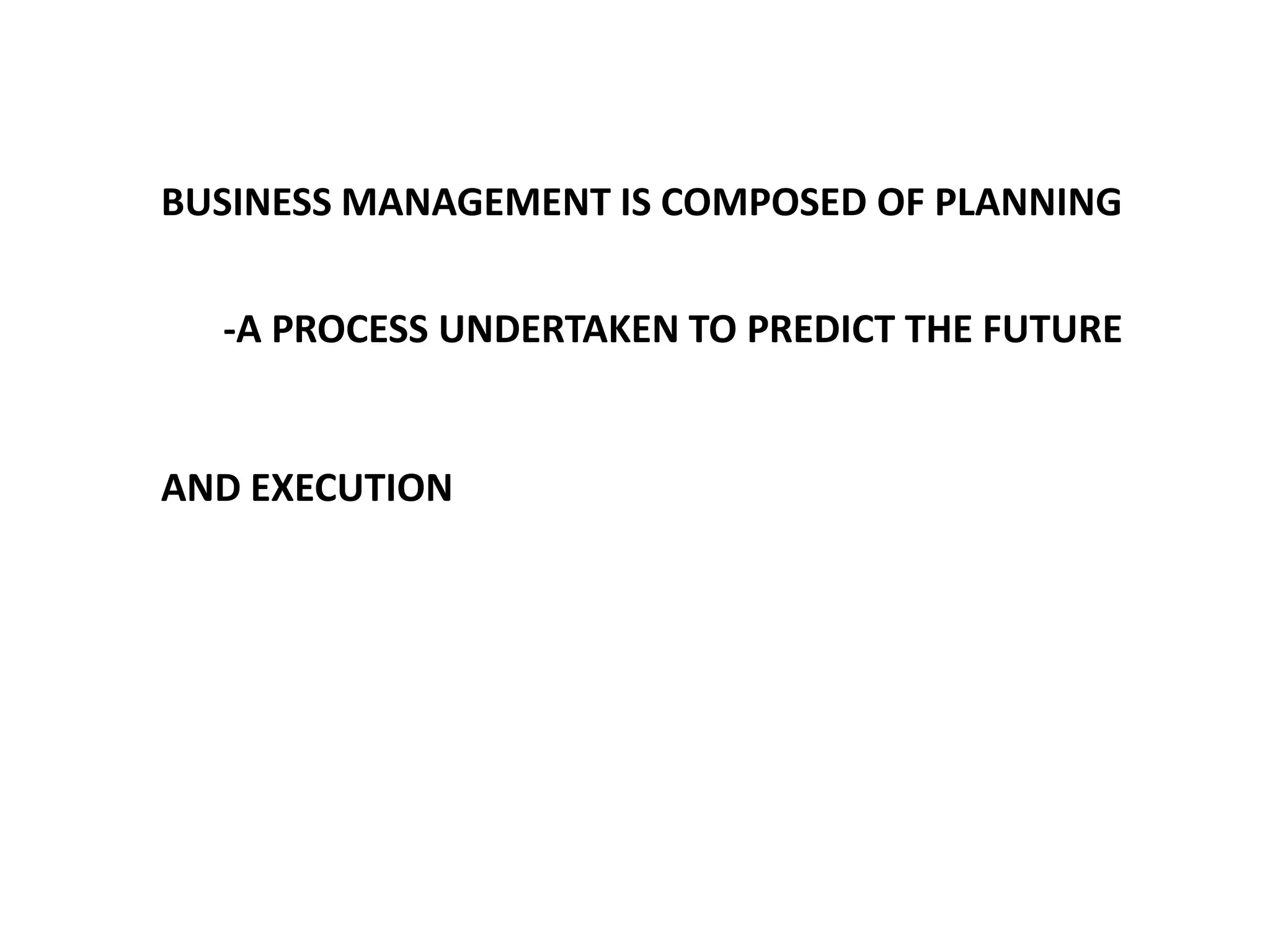

BUSINESS MANAGEMENT IS COMPOSED OF PLANNING

-A PROCESS UNDERTAKEN TO PREDICT THE FUTURE

AND EXECUTION
BUSINESS MANAGEMENT IS COMPOSED OF PLANNING

-A PROCESS UNDERTAKEN TO PREDICT THE FUTURE

AND EXECUTION
-COMPLETING TASKS THAT WERE DEFINED IN THE PAST

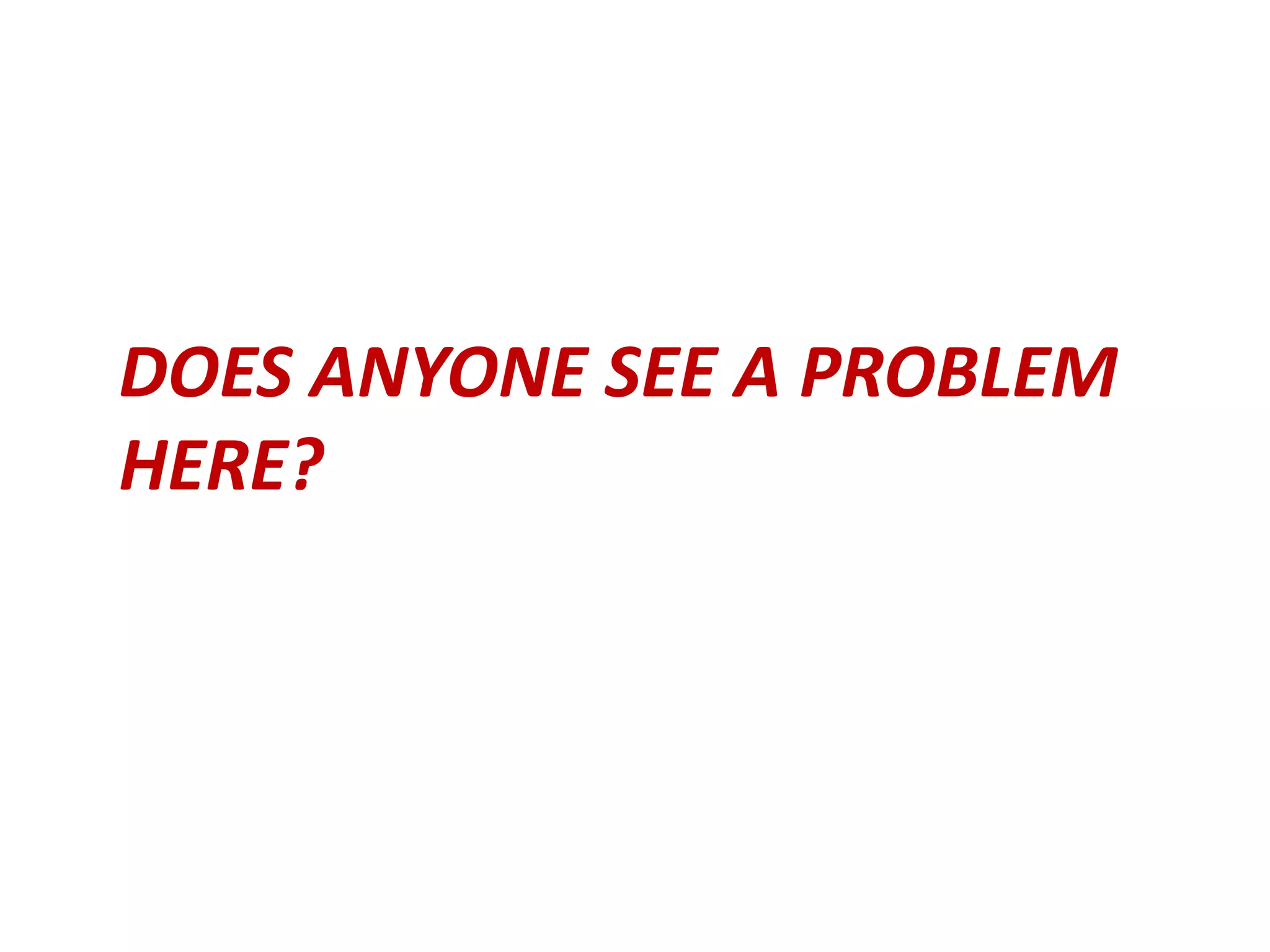

DOES ANYONE SEE A PROBLEM
HERE?
HUMANS CANNOT
PREDICT THE FUTURE

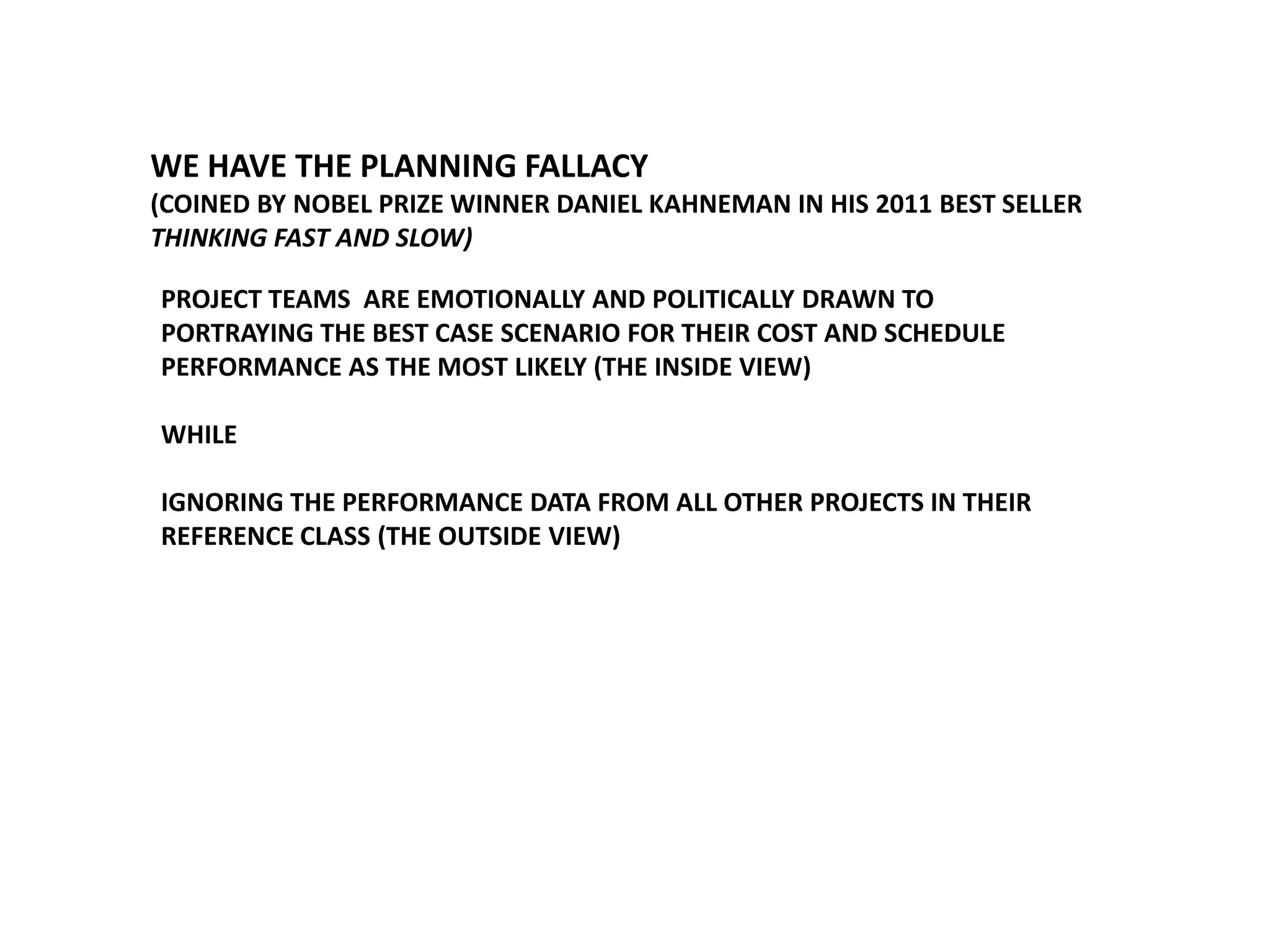

WE HAVE THE PLANNING FALLACY
(COINED BY NOBEL PRIZE WINNER DANIEL KAHNEMAN IN HIS 2011 BEST SELLER
THINKING FAST AND SLOW)
PROJECT TEAMS ARE EMOTIONALLY AND POLITICALLY DRAWN TO
PORTRAYING THE BEST CASE SCENARIO FOR THEIR COST AND SCHEDULE
PERFORMANCE AS THE MOST LIKELY (THE INSIDE VIEW)
WHILE
IGNORING THE PERFORMANCE DATA FROM ALL OTHER PROJECTS IN THEIR
REFERENCE CLASS (THE OUTSIDE VIEW)

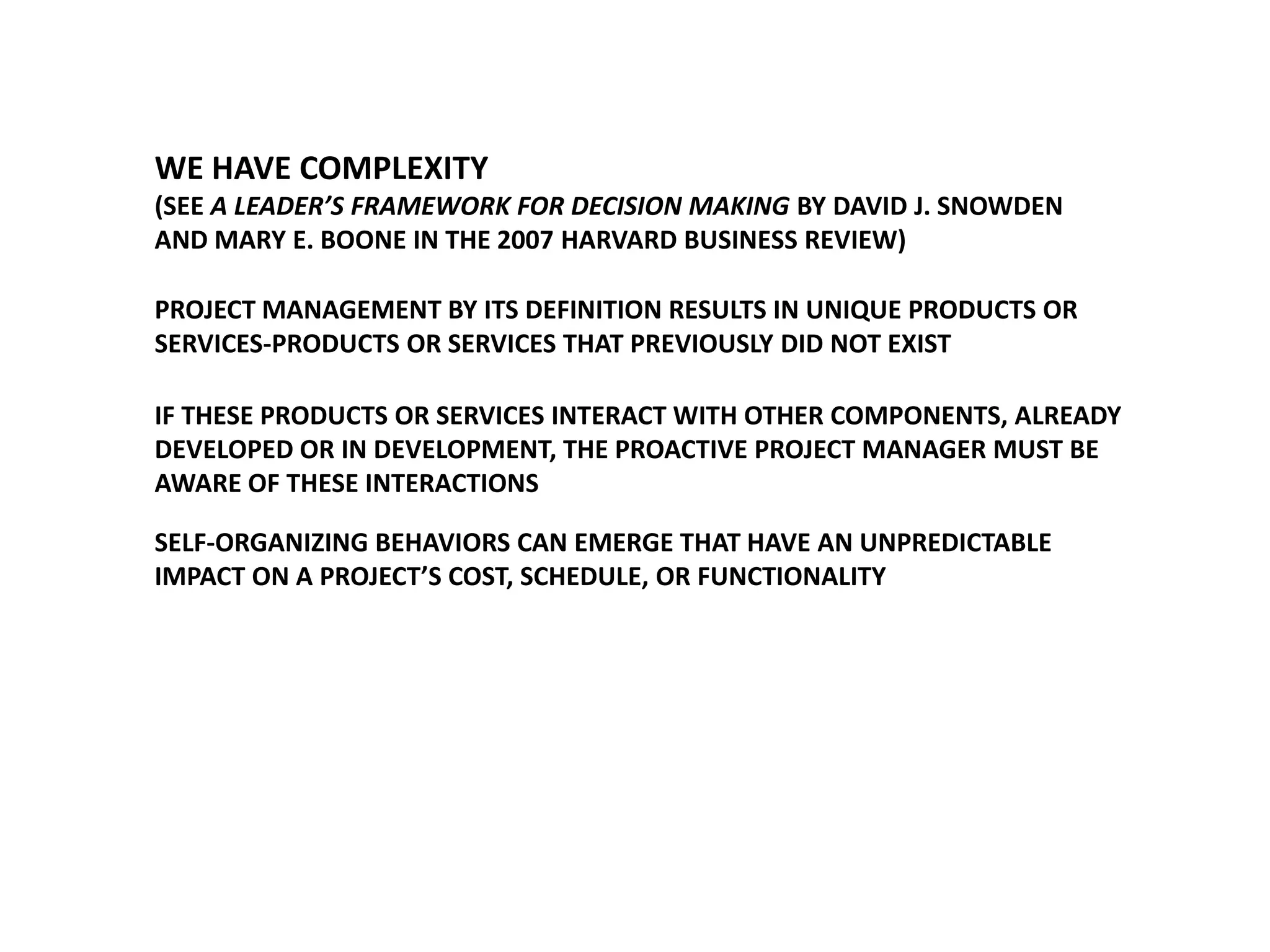

WE HAVE COMPLEXITY
(SEE A LEADER’S FRAMEWORK FOR DECISION MAKING BY DAVID J. SNOWDEN
AND MARY E. BOONE IN THE 2007 HARVARD BUSINESS REVIEW)

PROJECT MANAGEMENT BY ITS DEFINITION RESULTS IN UNIQUE PRODUCTS OR
SERVICES-PRODUCTS OR SERVICES THAT PREVIOUSLY DID NOT EXIST
IF THESE PRODUCTS OR SERVICES INTERACT WITH OTHER COMPONENTS, ALREADY
DEVELOPED OR IN DEVELOPMENT, THE PROACTIVE PROJECT MANAGER MUST BE
AWARE OF THESE INTERACTIONS

SELF-ORGANIZING BEHAVIORS CAN EMERGE THAT HAVE AN UNPREDICTABLE
IMPACT ON A PROJECT’S COST, SCHEDULE, OR FUNCTIONALITY

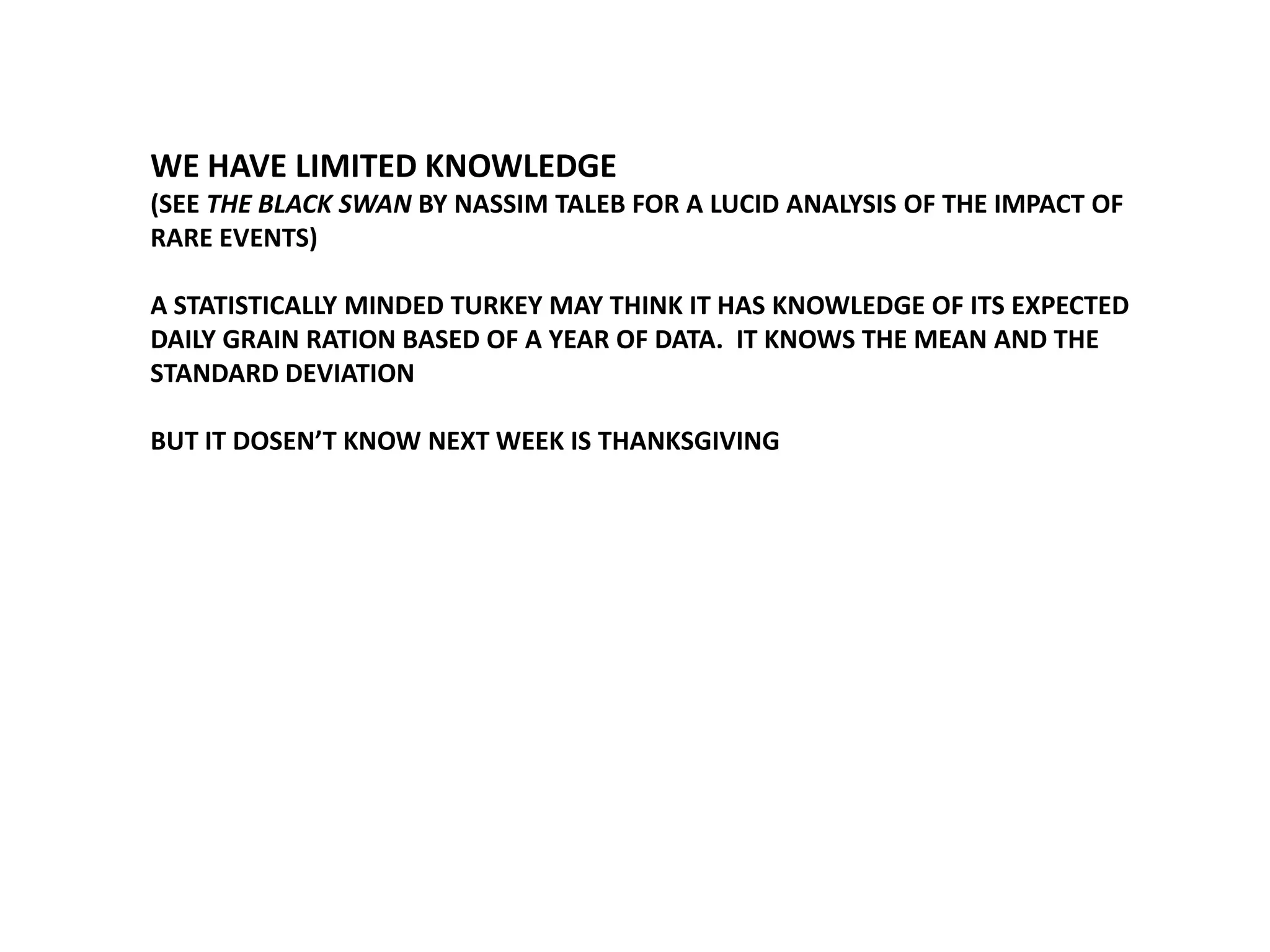

WE HAVE LIMITED KNOWLEDGE
(SEE THE BLACK SWAN BY NASSIM TALEB FOR A LUCID ANALYSIS OF THE IMPACT OF
RARE EVENTS)
A STATISTICALLY MINDED TURKEY MAY THINK IT HAS KNOWLEDGE OF ITS EXPECTED
DAILY GRAIN RATION BASED OF A YEAR OF DATA. IT KNOWS THE MEAN AND THE
STANDARD DEVIATION
BUT IT DOSEN’T KNOW NEXT WEEK IS THANKSGIVING

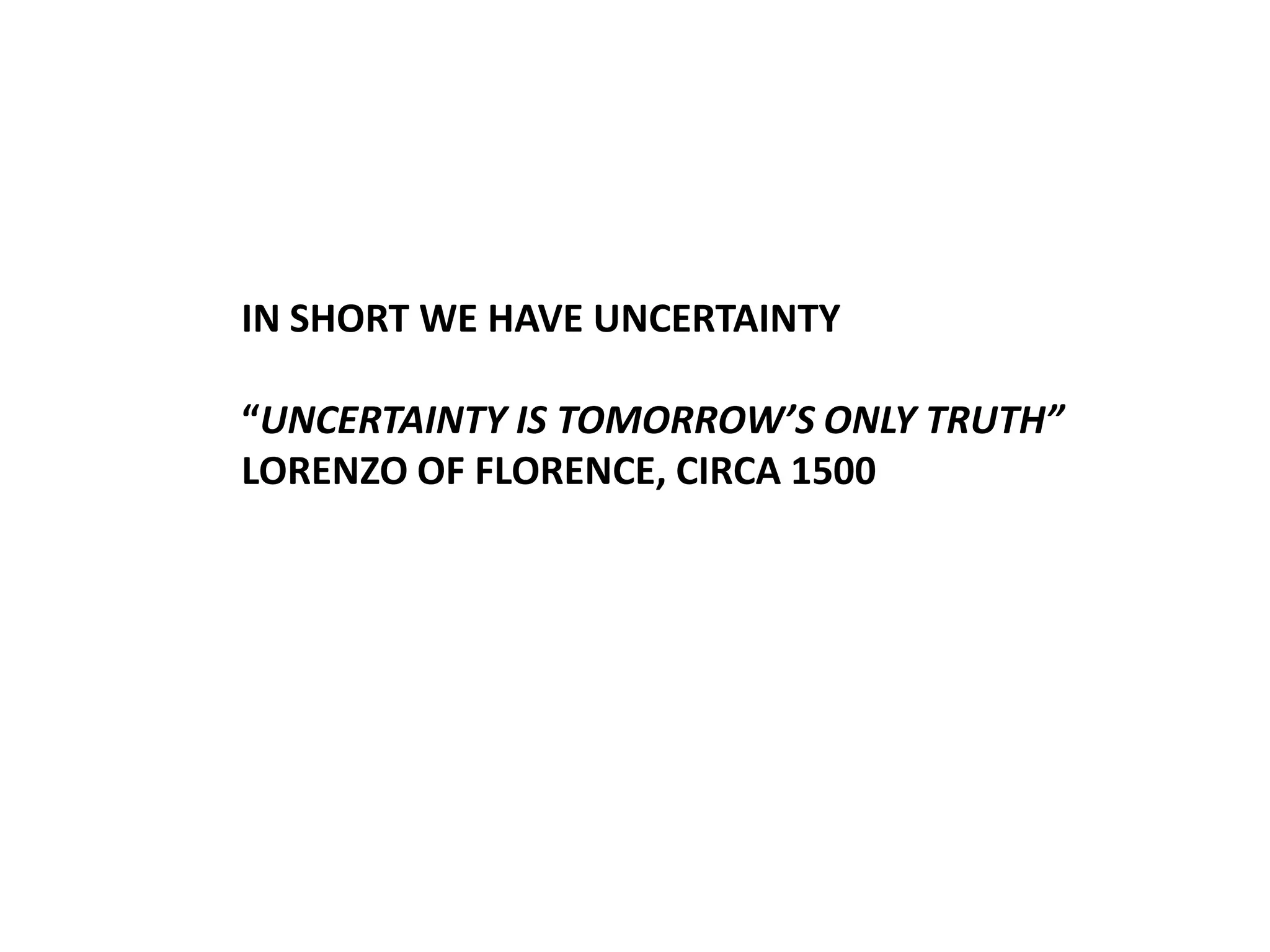

IN SHORT WE HAVE UNCERTAINTY
“UNCERTAINTY IS TOMORROW’S ONLY TRUTH”
LORENZO OF FLORENCE, CIRCA 1500

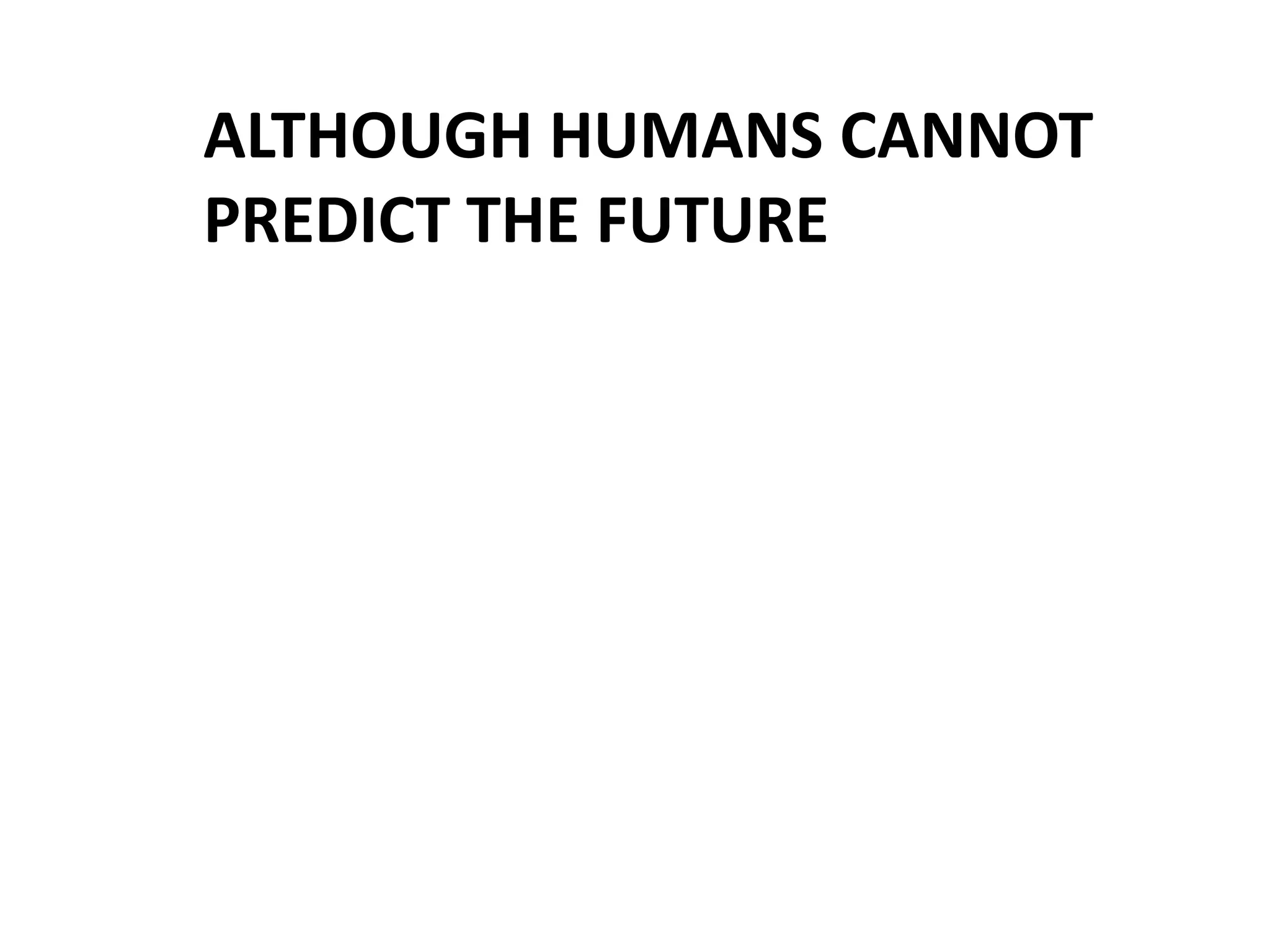

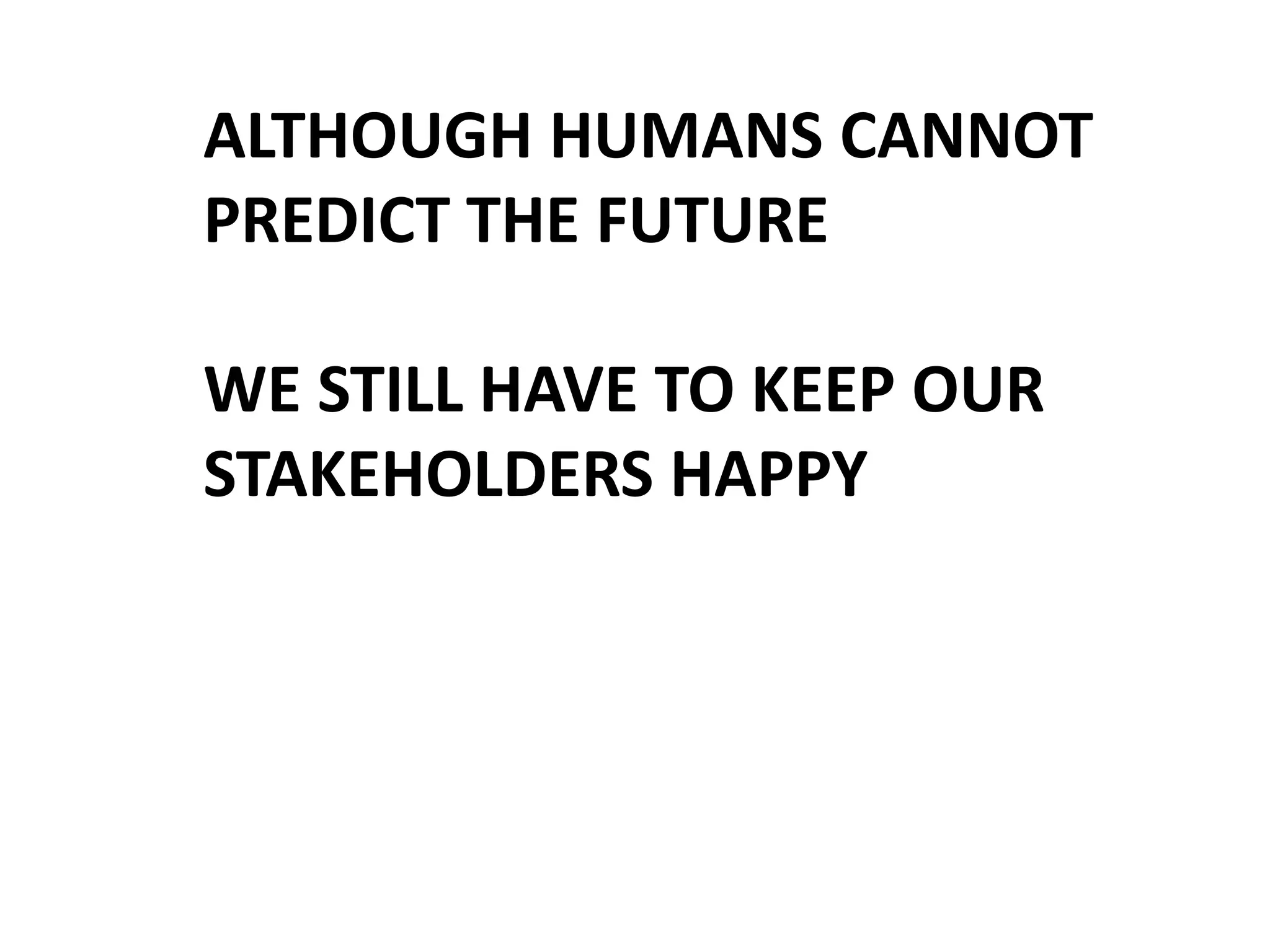

ALTHOUGH HUMANS CANNOT
PREDICT THE FUTURE
ALTHOUGH HUMANS CANNOT
PREDICT THE FUTURE
WE STILL HAVE TO KEEP OUR
STAKEHOLDERS HAPPY
ALTHOUGH HUMANS CANNOT
PREDICT THE FUTURE
WE STILL HAVE TO KEEP OUR
STAKEHOLDERS HAPPY

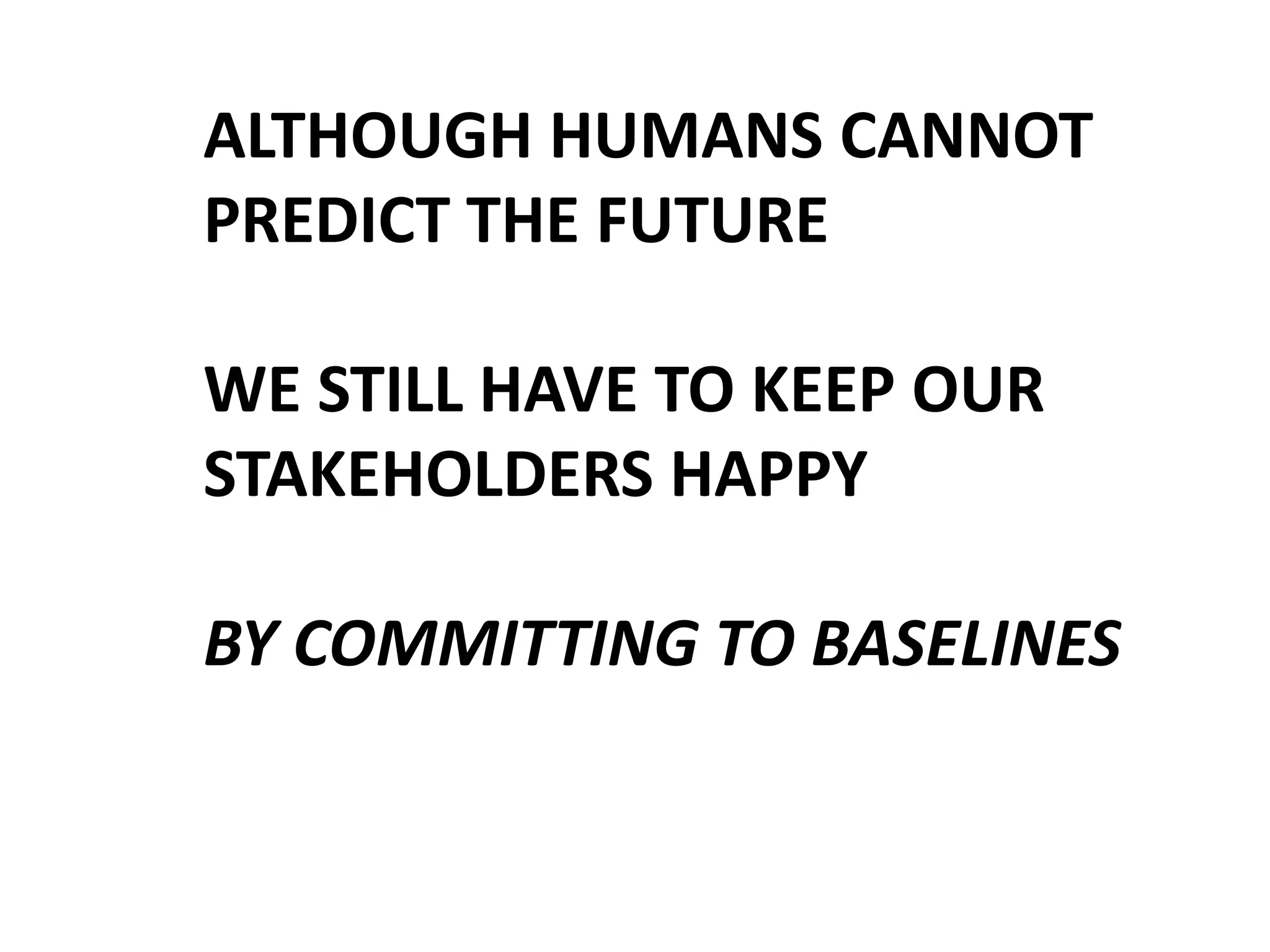

BY COMMITTING TO BASELINES
IN THE PLANNING PHASE WE JUGGLE THE BALLS OF
FUNCTIONALITY COST AND SCHEDULE UNTIL WE
HAVE AN EXECUTABLE BASELINE
-at least we think it is

BASELINE

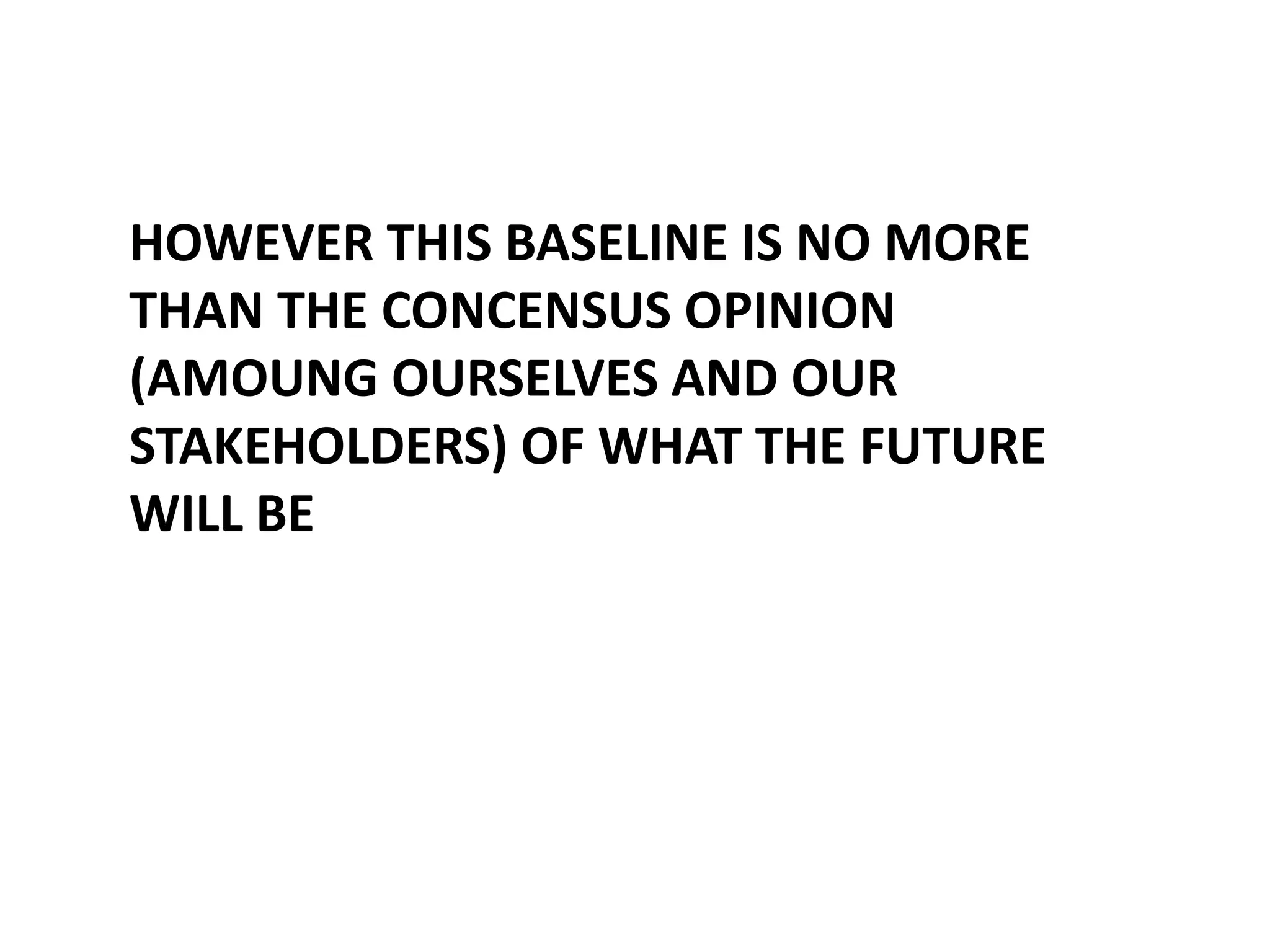

HOWEVER THIS BASELINE IS NO MORE
THAN THE CONCENSUS OPINION
(AMOUNG OURSELVES AND OUR
STAKEHOLDERS) OF WHAT THE FUTURE
WILL BE
THE STAKEHOLDERS WATCH US AND OFFER
THEIR OPINION ON OUR ABILITY TO BUILD
THIS BASELINE

Nice job
Very thorough

BASELINE

Nice suit
Can I leave now
THE FUTURE COMES SOONER THAN WE THINK AND IN
THE EXECUTION PHASE JUGGLING BALLS TURNS INTO
JUGGLING CHAINSAWS AND THE TERRA FIRMA OF THE
PLAN YEILDS TO UNCERTAINTY
-you’re a little more interesting to watch now
SCHEDULE
SCOPE
COST
AND NOW THE STAKEHOLDERS
BECOME MORE ANIMATED
SCHEDULE

SCOPE
COST

Who decided that

What were you thinking

That’s gonna cost us

Where’s the risk management
been on this project

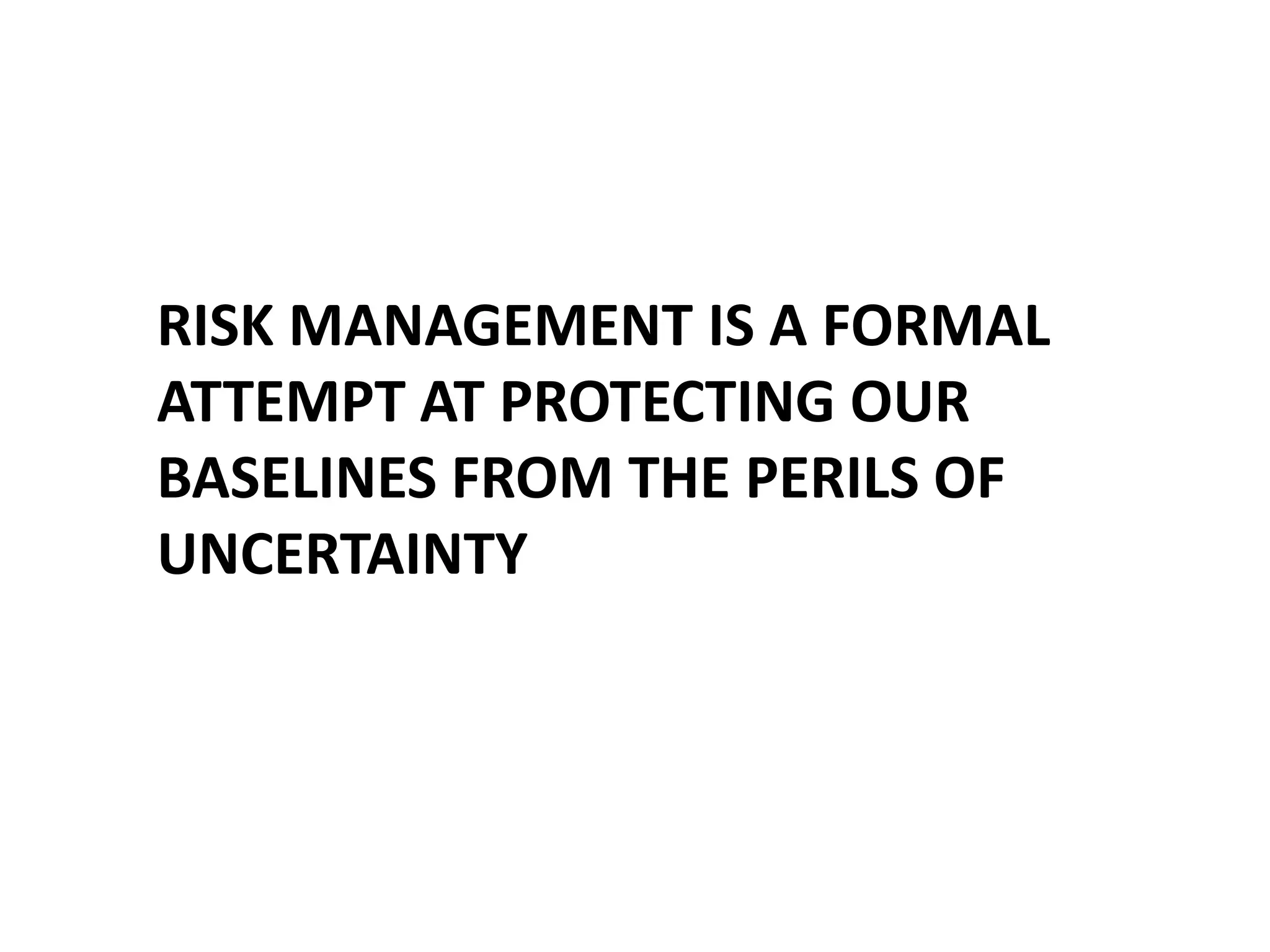

RISK MANAGEMENT IS A FORMAL
ATTEMPT AT PROTECTING OUR
BASELINES FROM THE PERILS OF
UNCERTAINTY

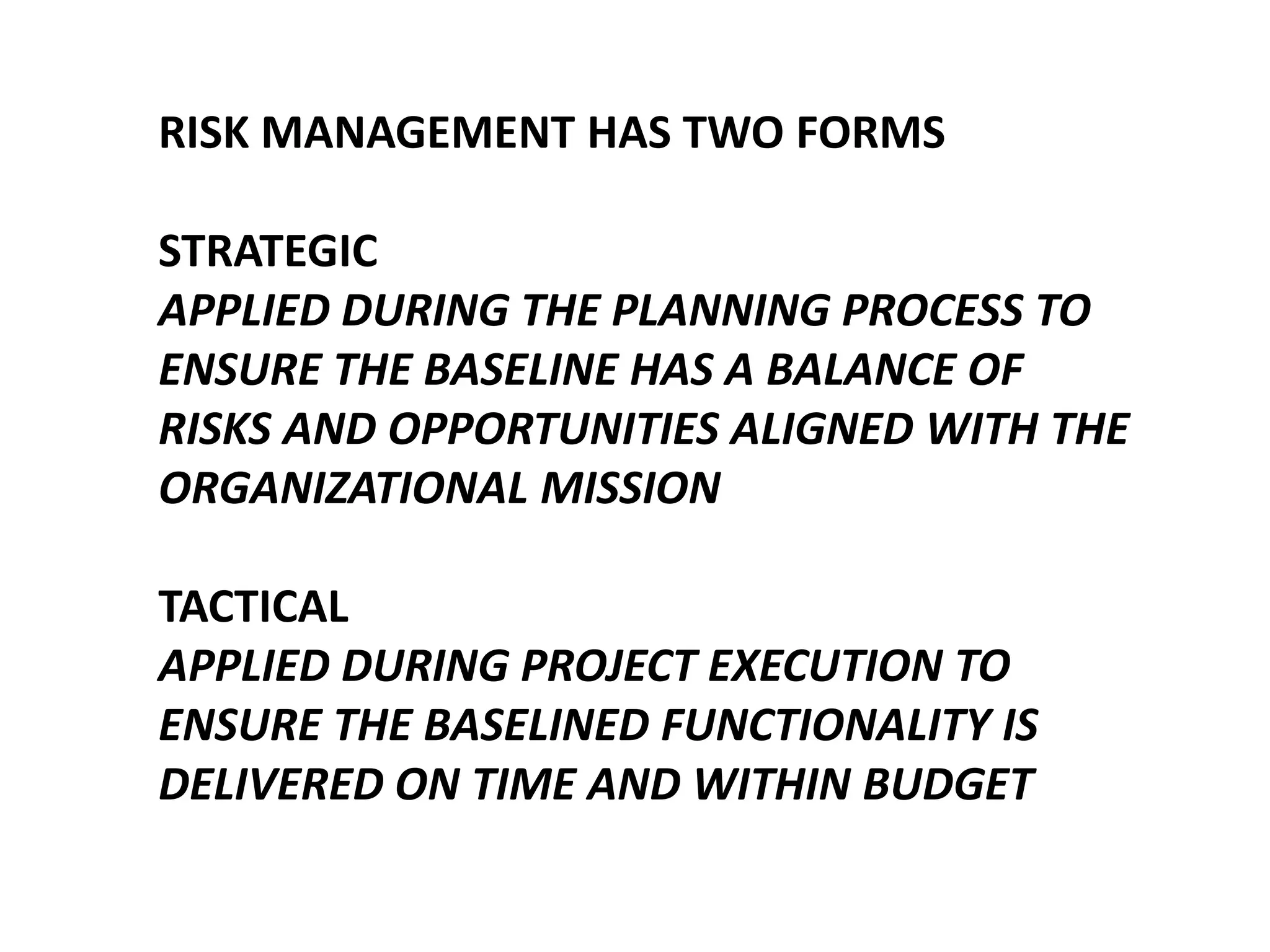

RISK MANAGEMENT HAS TWO FORMS
STRATEGIC
APPLIED DURING THE PLANNING PROCESS TO
ENSURE THE BASELINE HAS A BALANCE OF
RISKS AND OPPORTUNITIES ALIGNED WITH THE
ORGANIZATIONAL MISSION
TACTICAL
APPLIED DURING PROJECT EXECUTION TO
ENSURE THE BASELINED FUNCTIONALITY IS
DELIVERED ON TIME AND WITHIN BUDGET

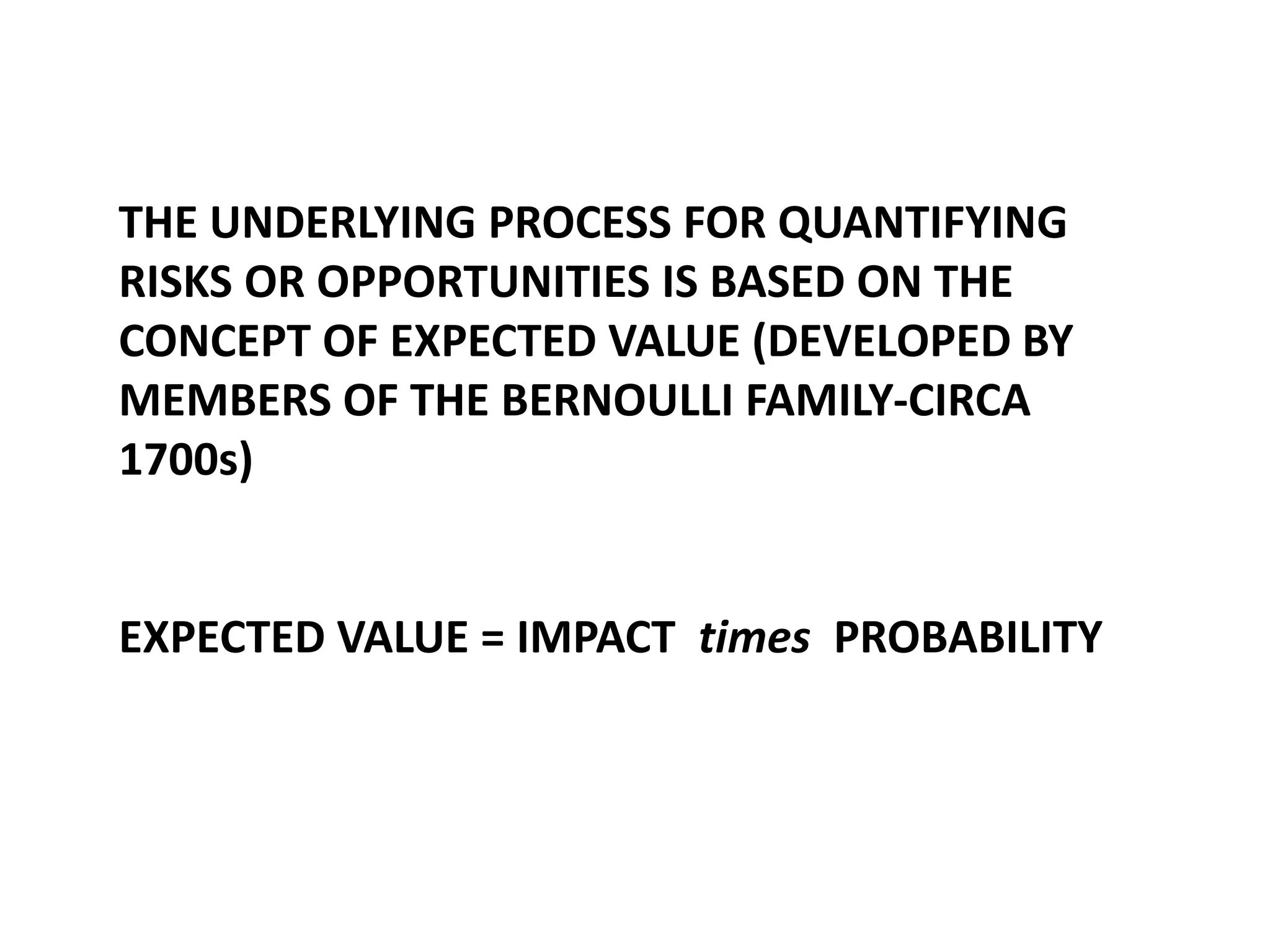

THE UNDERLYING PROCESS FOR QUANTIFYING
RISKS OR OPPORTUNITIES IS BASED ON THE
CONCEPT OF EXPECTED VALUE (DEVELOPED BY
MEMBERS OF THE BERNOULLI FAMILY-CIRCA
1700s)

EXPECTED VALUE = IMPACT times PROBABILITY

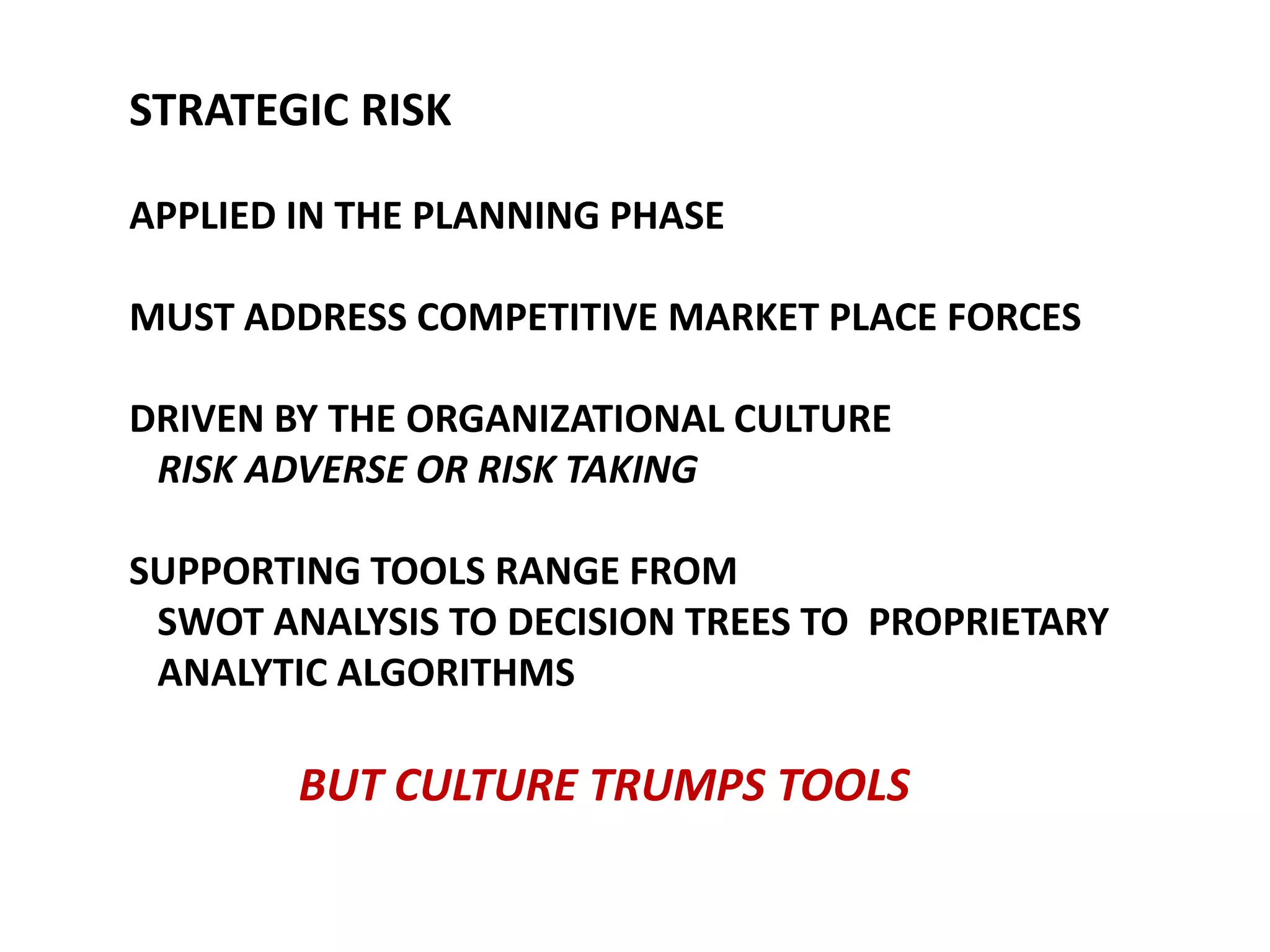

STRATEGIC RISK
APPLIED IN THE PLANNING PHASE
MUST ADDRESS COMPETITIVE MARKET PLACE FORCES
DRIVEN BY THE ORGANIZATIONAL CULTURE
RISK ADVERSE OR RISK TAKING
SUPPORTING TOOLS RANGE FROM
SWOT ANALYSIS TO DECISION TREES TO PROPRIETARY
ANALYTIC ALGORITHMS

BUT CULTURE TRUMPS TOOLS

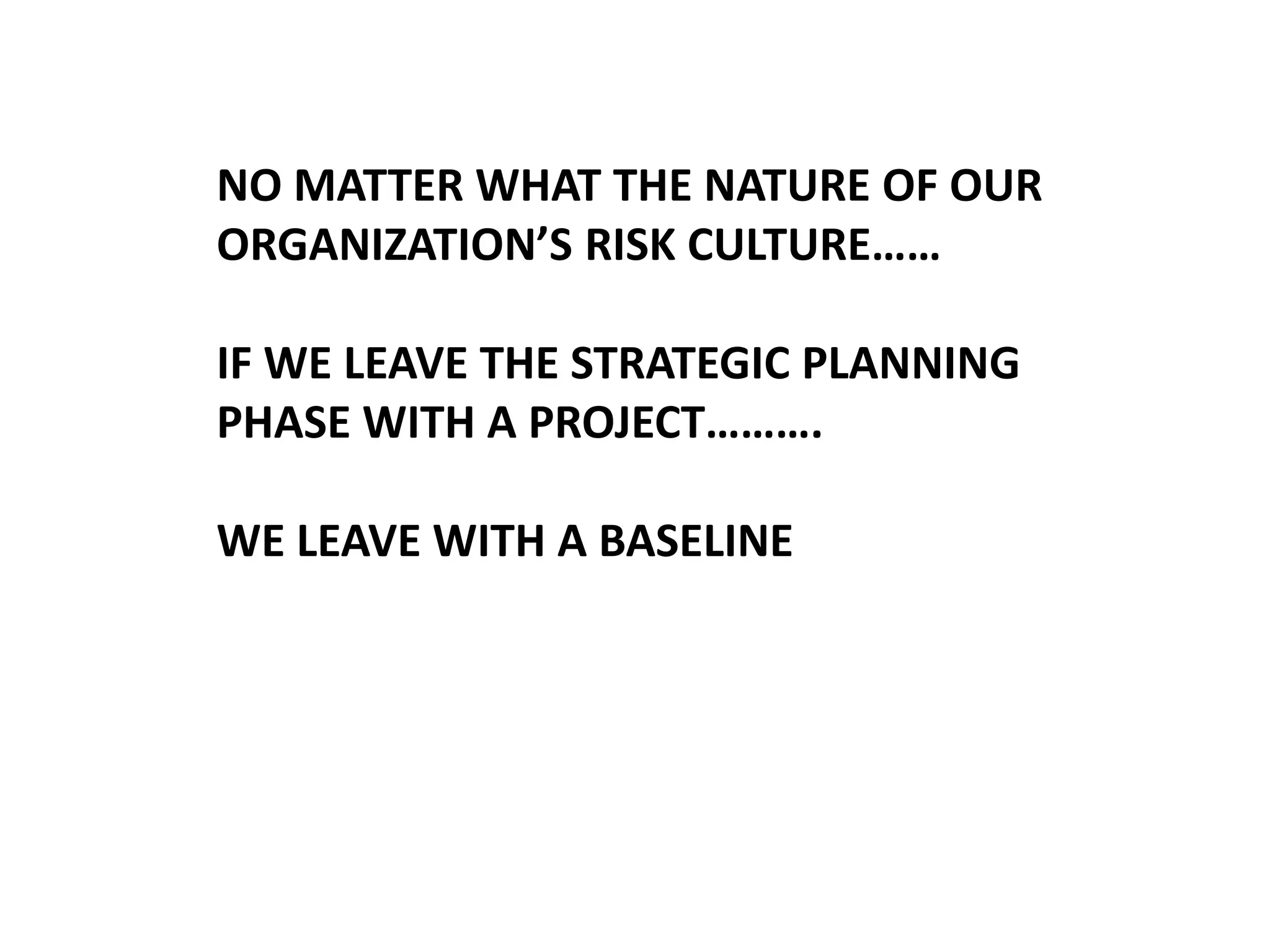

NO MATTER WHAT THE NATURE OF OUR
ORGANIZATION’S RISK CULTURE……
IF WE LEAVE THE STRATEGIC PLANNING
PHASE WITH A PROJECT……….

WE LEAVE WITH A BASELINE
RISK

BASELINE
SOME RISKS ARE RETIRED IN
BASELINE DECISIONS

SOME ARE ACCEPTED IN BASELINE
DECISIONS BECAUSE OF THE
OPPORTUNITIES THEY ALLOW
Risk Management Occurs During Planning
(Strategic) and Execution (Tactical)
RISK

RISK
SOME
AREN’T

BASELINE
WHILE SOME RISKS ARE
RETIRED IN BASELINE
DECISIONS

A RISK TEMPLATE IS USED AS A
MANAGEMENT TOOL DURING
PROJECT EXECUTION

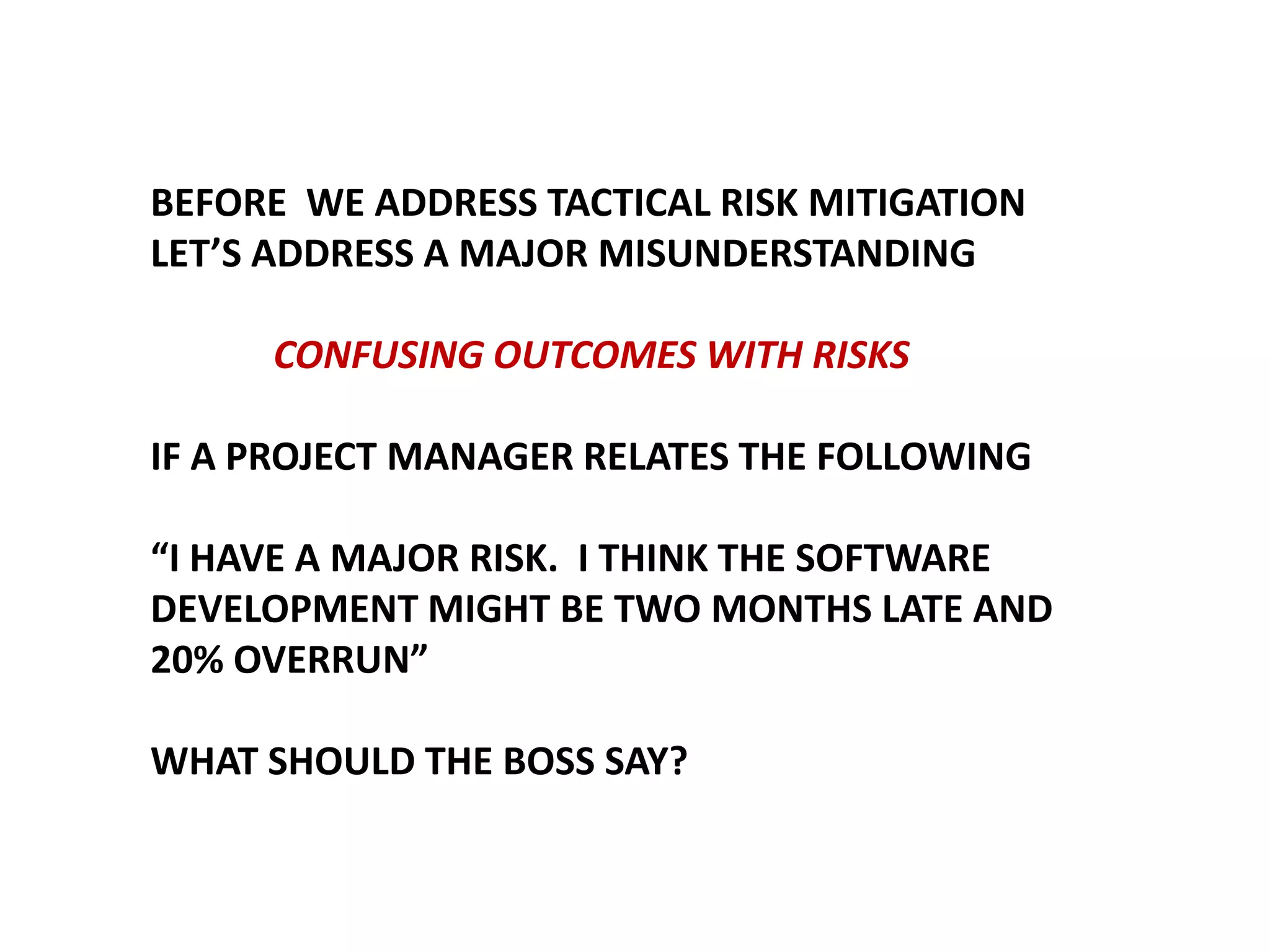

BEFORE WE ADDRESS TACTICAL RISK MITIGATION
LET’S ADDRESS A MAJOR MISUNDERSTANDING

CONFUSING OUTCOMES WITH RISKS
IF A PROJECT MANAGER RELATES THE FOLLOWING
“I HAVE A MAJOR RISK. I THINK THE SOFTWARE
DEVELOPMENT MIGHT BE TWO MONTHS LATE AND
20% OVERRUN”
WHAT SHOULD THE BOSS SAY?

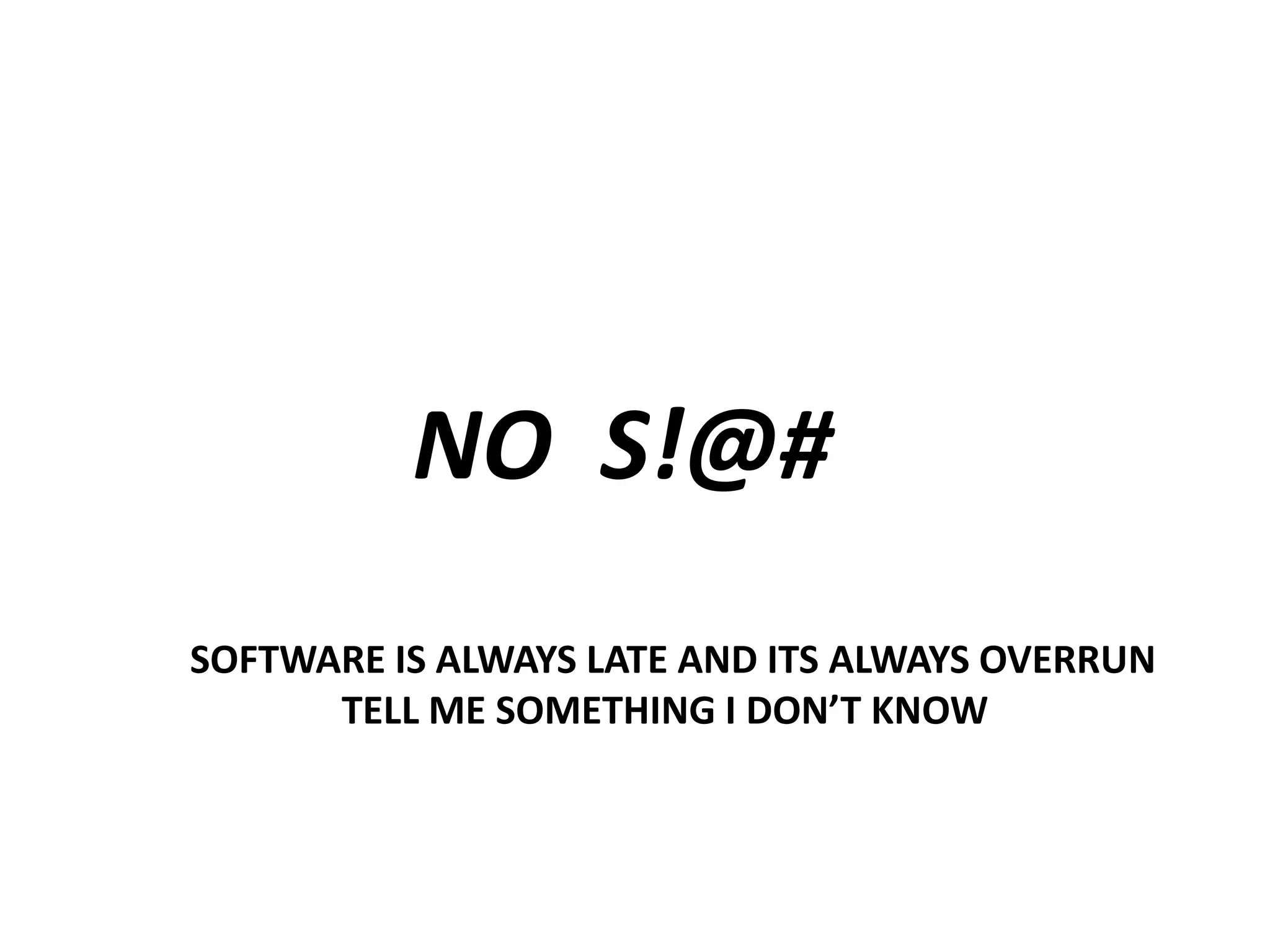

NO S!@#
NO S!@#
SOFTWARE IS ALWAYS LATE AND ITS ALWAYS OVERRUN
TELL ME SOMETHING I DON’T KNOW

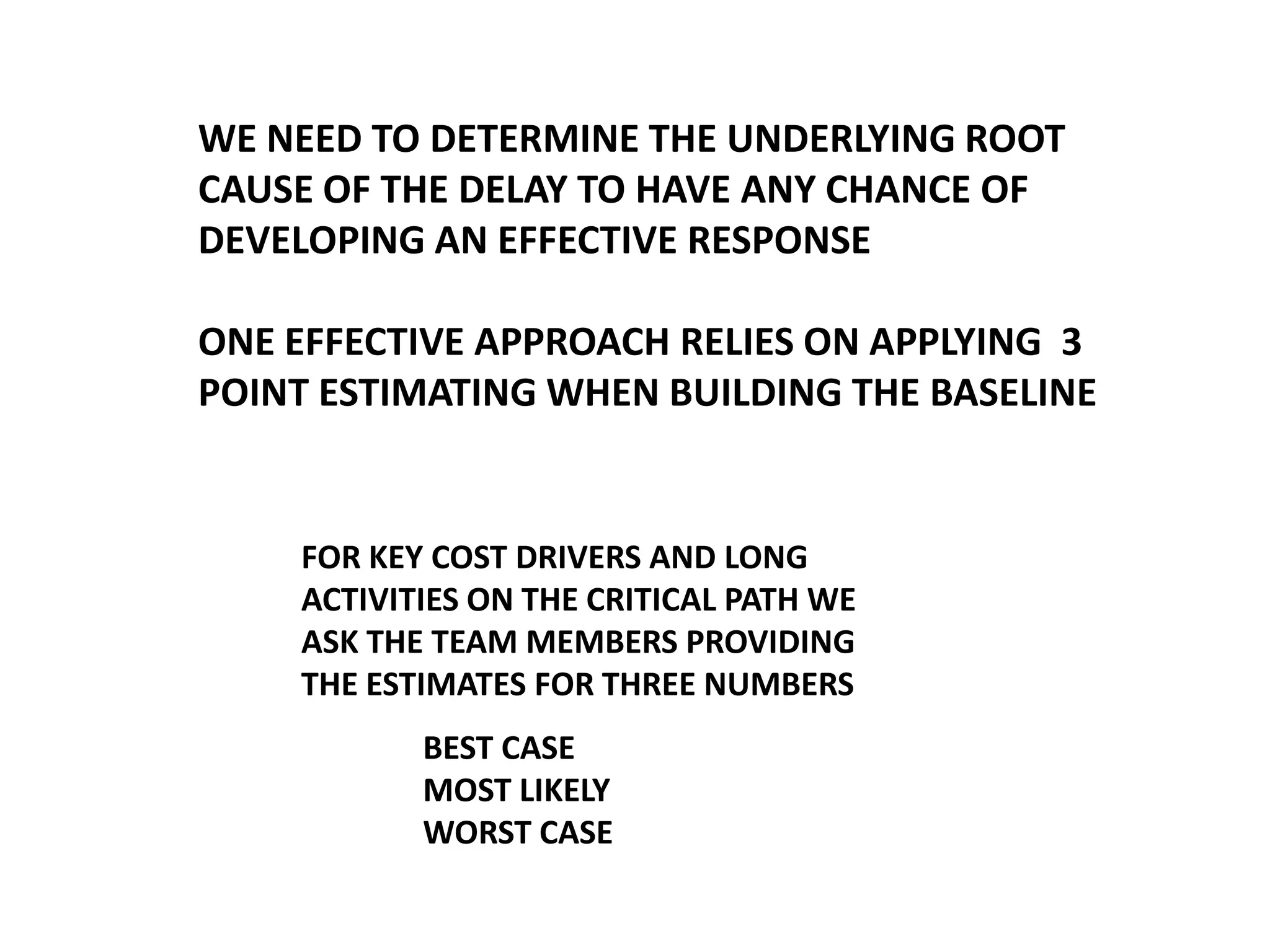

WE NEED TO DETERMINE THE UNDERLYING ROOT
CAUSE OF THE DELAY TO HAVE ANY CHANCE OF
DEVELOPING AN EFFECTIVE RESPONSE

ONE EFFECTIVE APPROACH RELIES ON APPLYING 3
POINT ESTIMATING WHEN BUILDING THE BASELINE

FOR KEY COST DRIVERS AND LONG
ACTIVITIES ON THE CRITICAL PATH WE
ASK THE TEAM MEMBERS PROVIDING
THE ESTIMATES FOR THREE NUMBERS

BEST CASE
MOST LIKELY
WORST CASE

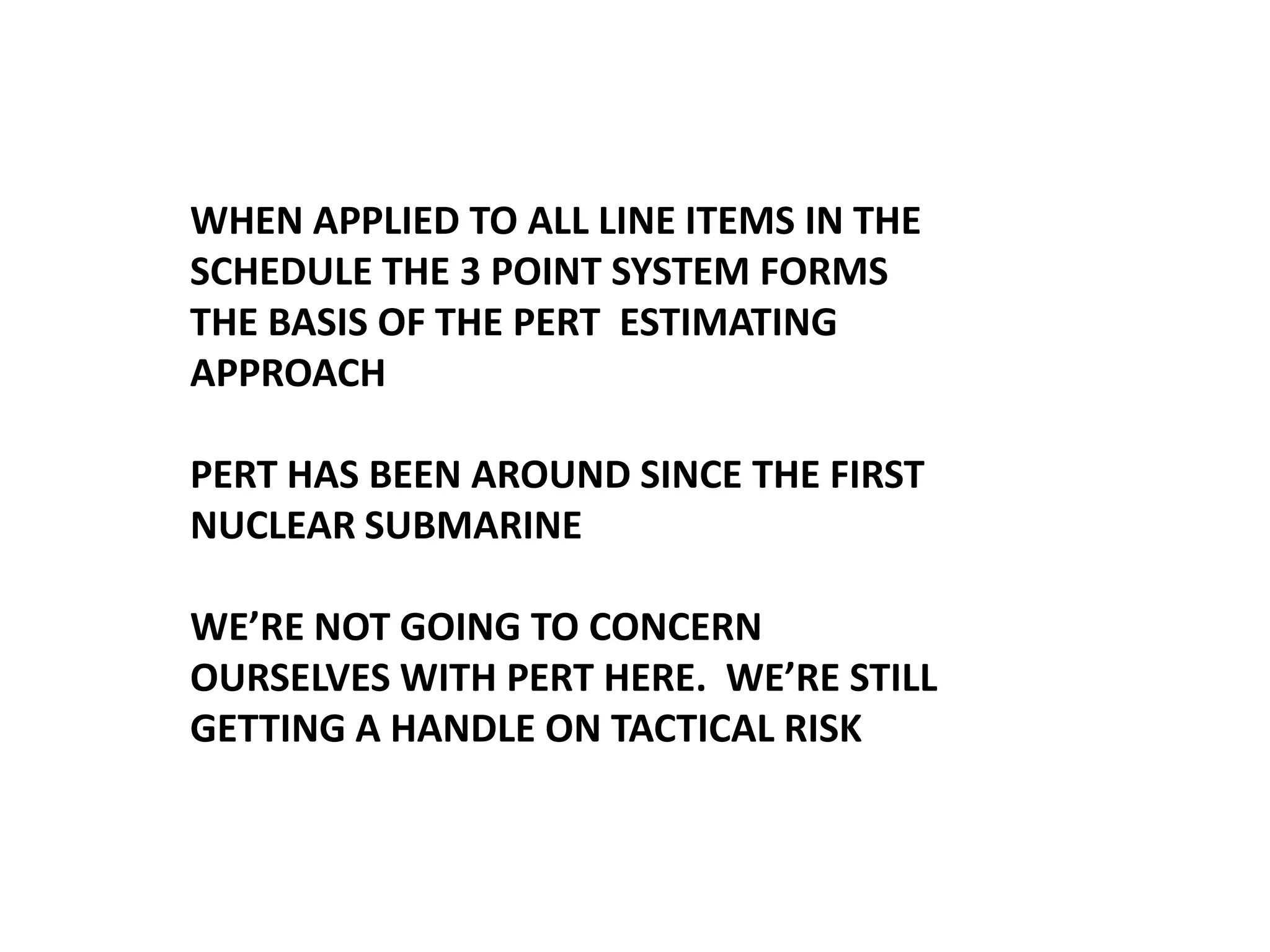

WHEN APPLIED TO ALL LINE ITEMS IN THE
SCHEDULE THE 3 POINT SYSTEM FORMS
THE BASIS OF THE PERT ESTIMATING
APPROACH
PERT HAS BEEN AROUND SINCE THE FIRST
NUCLEAR SUBMARINE
WE’RE NOT GOING TO CONCERN
OURSELVES WITH PERT HERE. WE’RE STILL
GETTING A HANDLE ON TACTICAL RISK

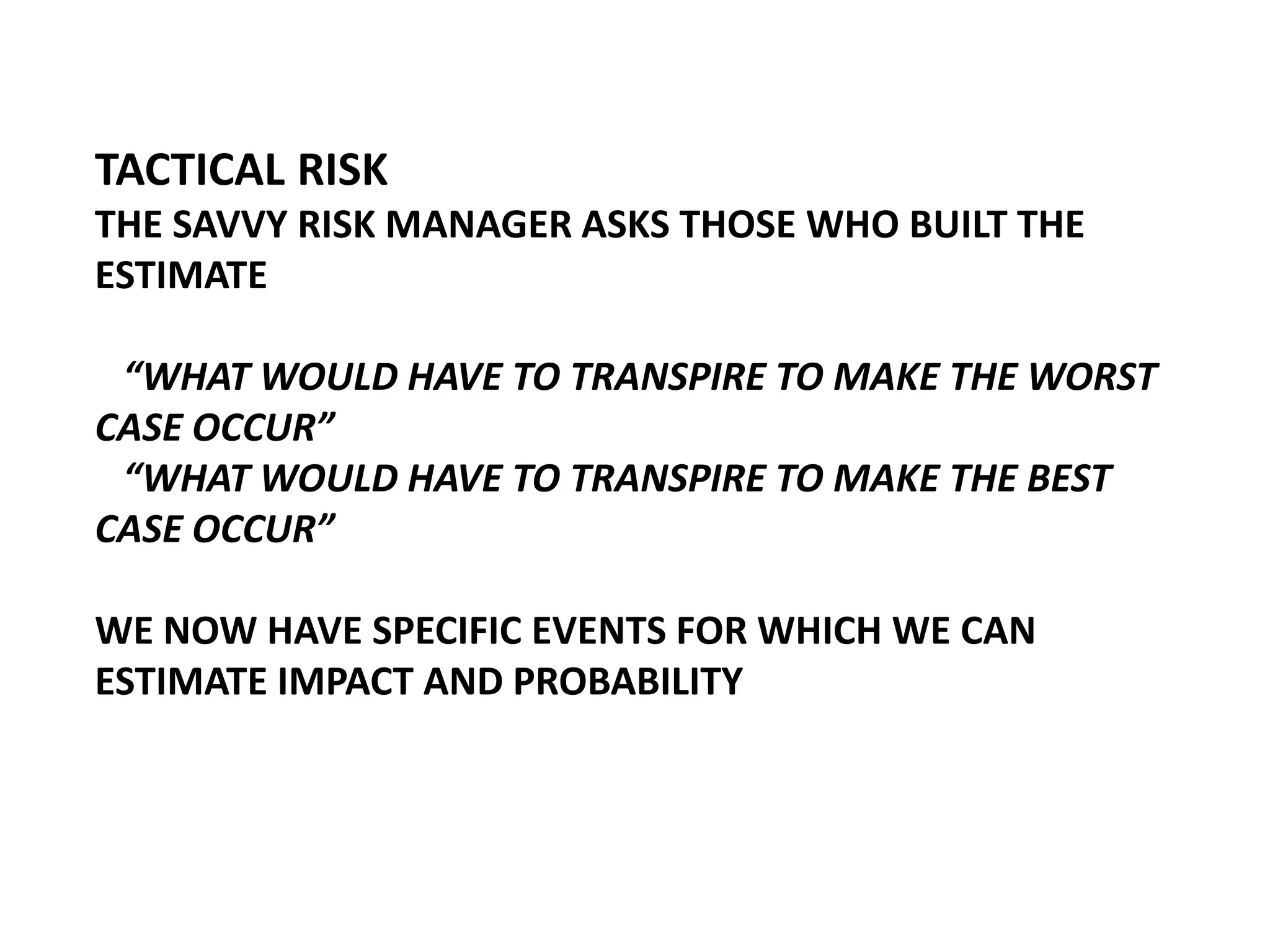

TACTICAL RISK
THE SAVVY RISK MANAGER ASKS THOSE WHO BUILT THE
ESTIMATE
“WHAT WOULD HAVE TO TRANSPIRE TO MAKE THE WORST
CASE OCCUR”
“WHAT WOULD HAVE TO TRANSPIRE TO MAKE THE BEST
CASE OCCUR”
WE NOW HAVE SPECIFIC EVENTS FOR WHICH WE CAN
ESTIMATE IMPACT AND PROBABILITY

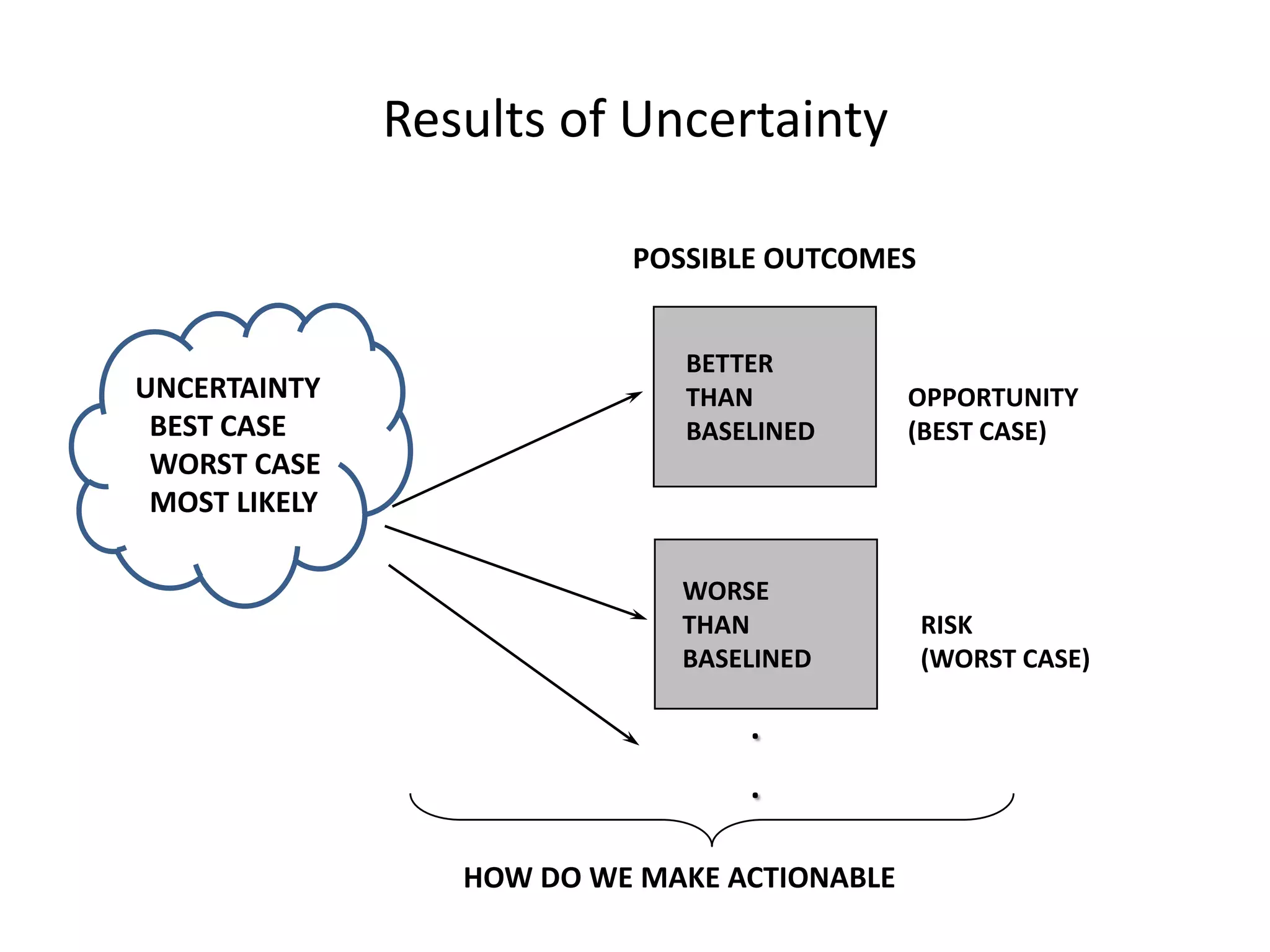

Results of Uncertainty
POSSIBLE OUTCOMES

UNCERTAINTY
BEST CASE
WORST CASE
MOST LIKELY

BETTER
THAN
BASELINED

WORSE
THAN
BASELINED

.
.
HOW DO WE MAKE ACTIONABLE

OPPORTUNITY
(BEST CASE)

RISK
(WORST CASE)

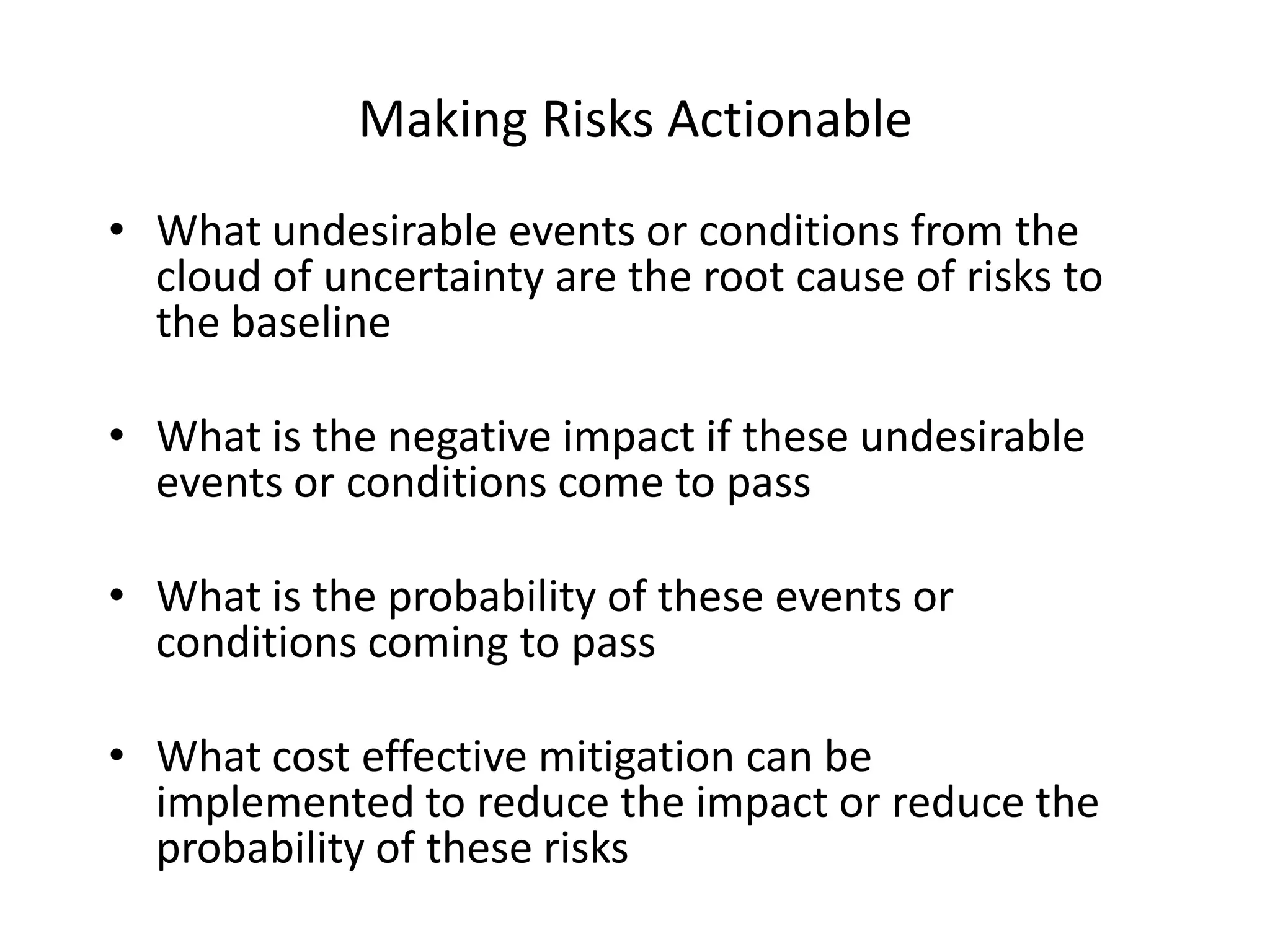

Making Risks Actionable
• What undesirable events or conditions from the
cloud of uncertainty are the root cause of risks to
the baseline

• What is the negative impact if these undesirable
events or conditions come to pass
• What is the probability of these events or
conditions coming to pass
• What cost effective mitigation can be
implemented to reduce the impact or reduce the
probability of these risks

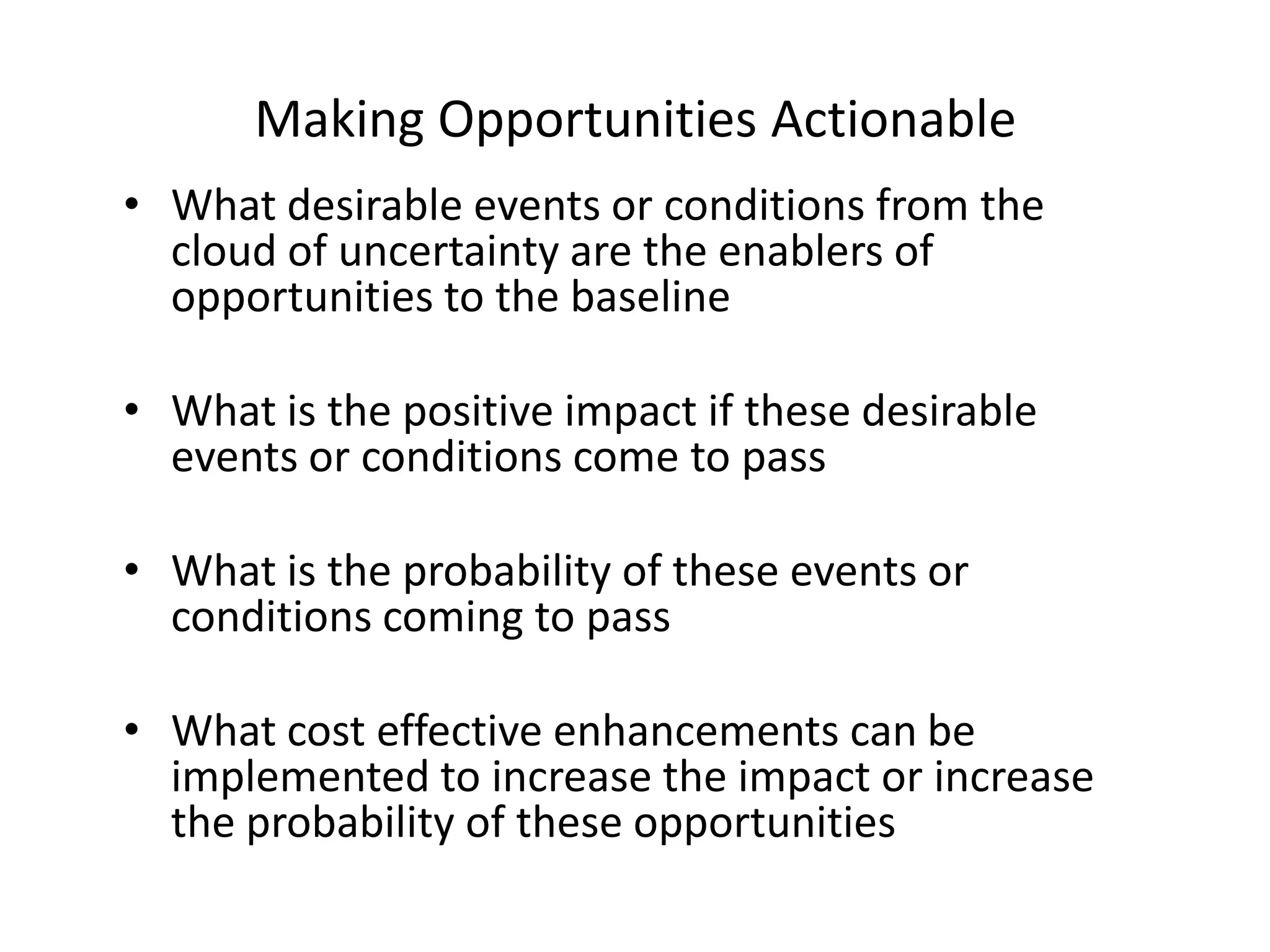

Making Opportunities Actionable
• What desirable events or conditions from the
cloud of uncertainty are the enablers of
opportunities to the baseline
• What is the positive impact if these desirable
events or conditions come to pass
• What is the probability of these events or
conditions coming to pass
• What cost effective enhancements can be
implemented to increase the impact or increase
the probability of these opportunities

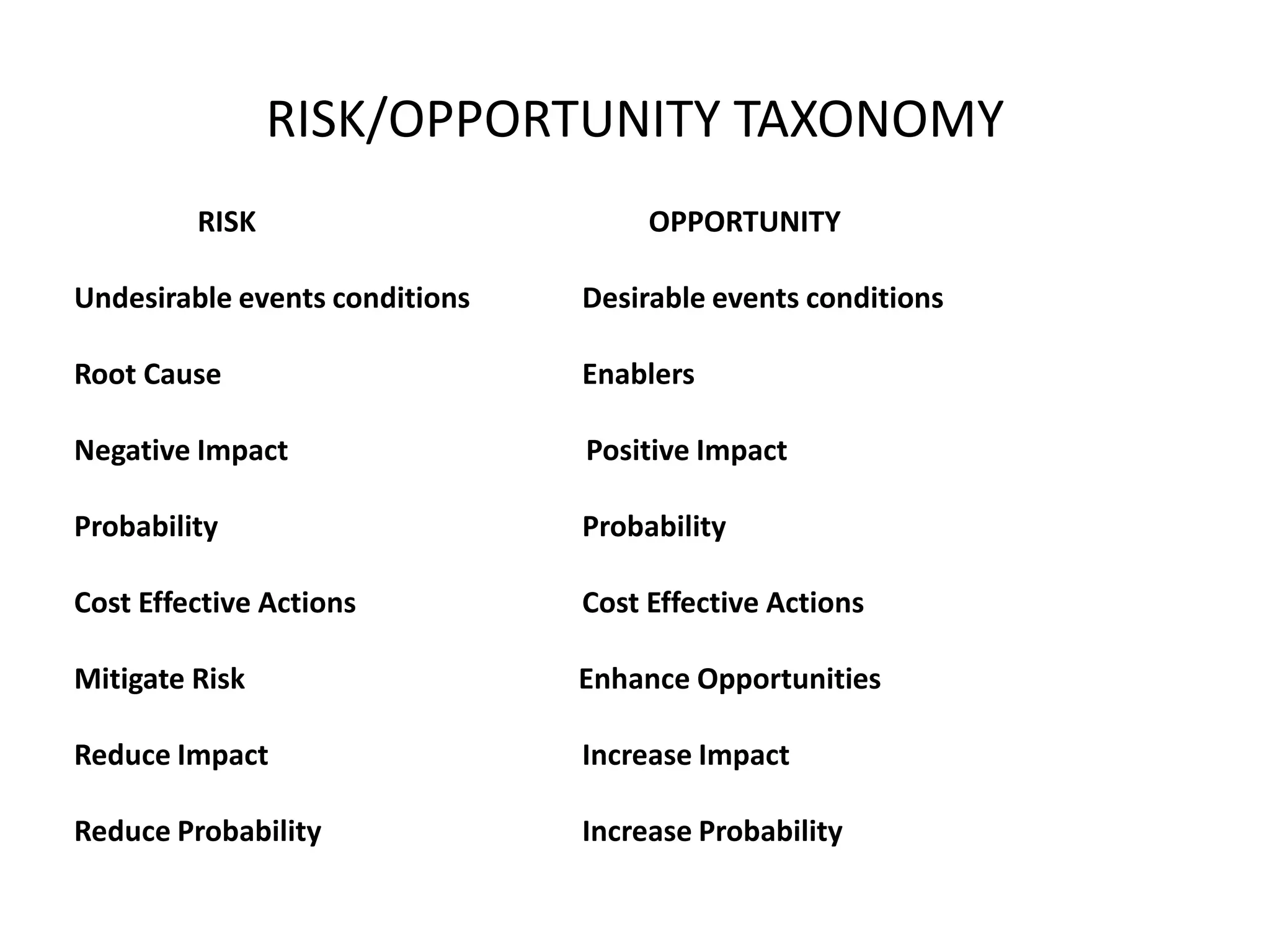

RISK/OPPORTUNITY TAXONOMY
RISK

OPPORTUNITY

Undesirable events conditions

Desirable events conditions

Root Cause

Enablers

Negative Impact

Positive Impact

Probability

Probability

Cost Effective Actions

Cost Effective Actions

Mitigate Risk

Enhance Opportunities

Reduce Impact

Increase Impact

Reduce Probability

Increase Probability

THE TACTICAL RISK TEMPLATE
RISK ROOT BASELINE
CAUSE ELEMENT
AFFECTED

IMPACT BY $ OR PROBABILITY EXPECTED
SCALE
VALUE

XXX

YYY
ZZZ
THE SAVVY PROJECY MANAGER PRIORTIZES THE RISK EVENTS BY
EXPECTED VALUE AND DEVOTES MANAGEMENT TIME TO MITIGATING
THE ROOT CAUSES OF THE TOP THREE TO FIVE RISKS TO THE BASELINE

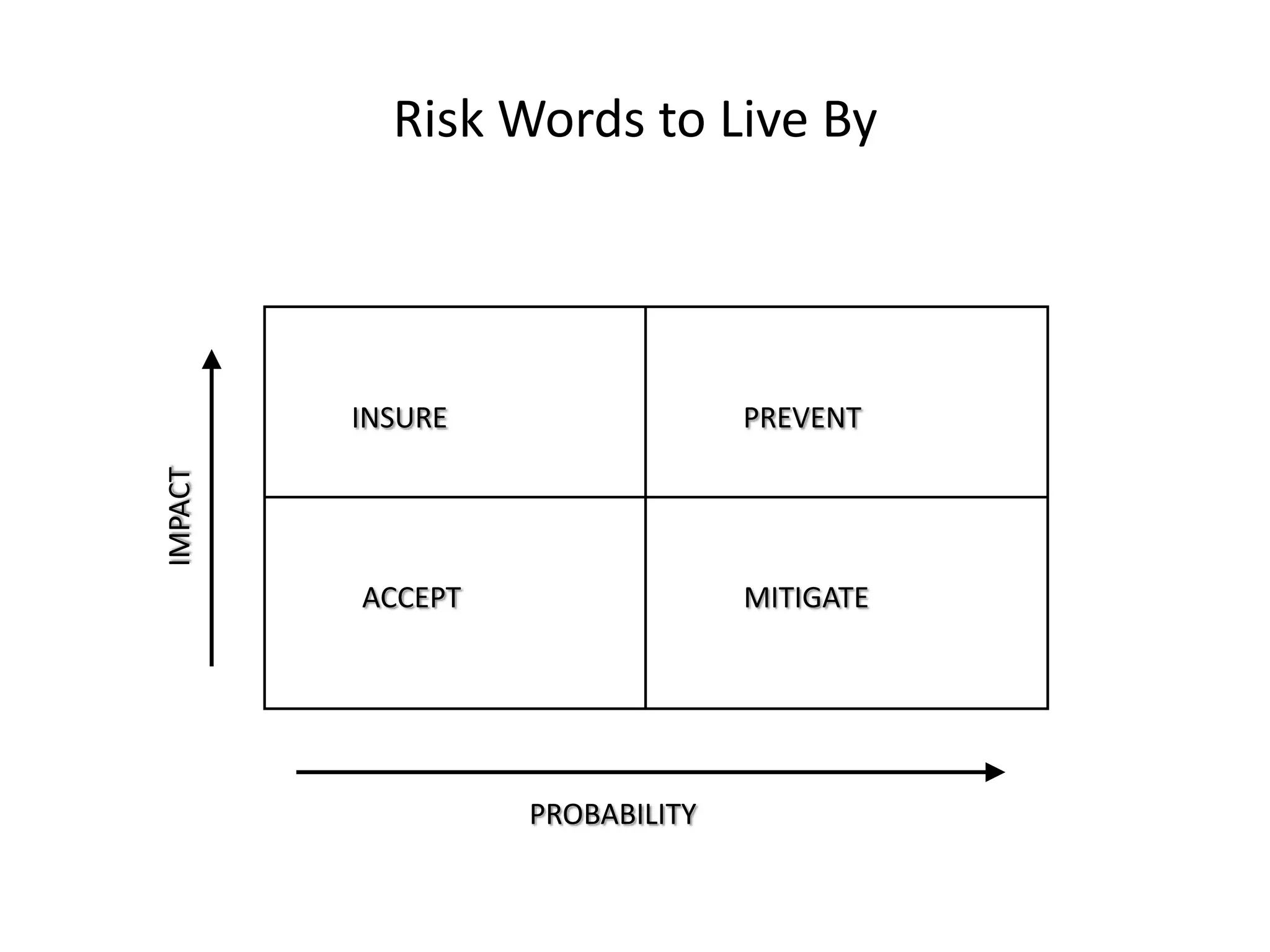

Risk Words to Live By

PREVENT

IMPACT

INSURE

ACCEPT

MITIGATE

PROBABILITY

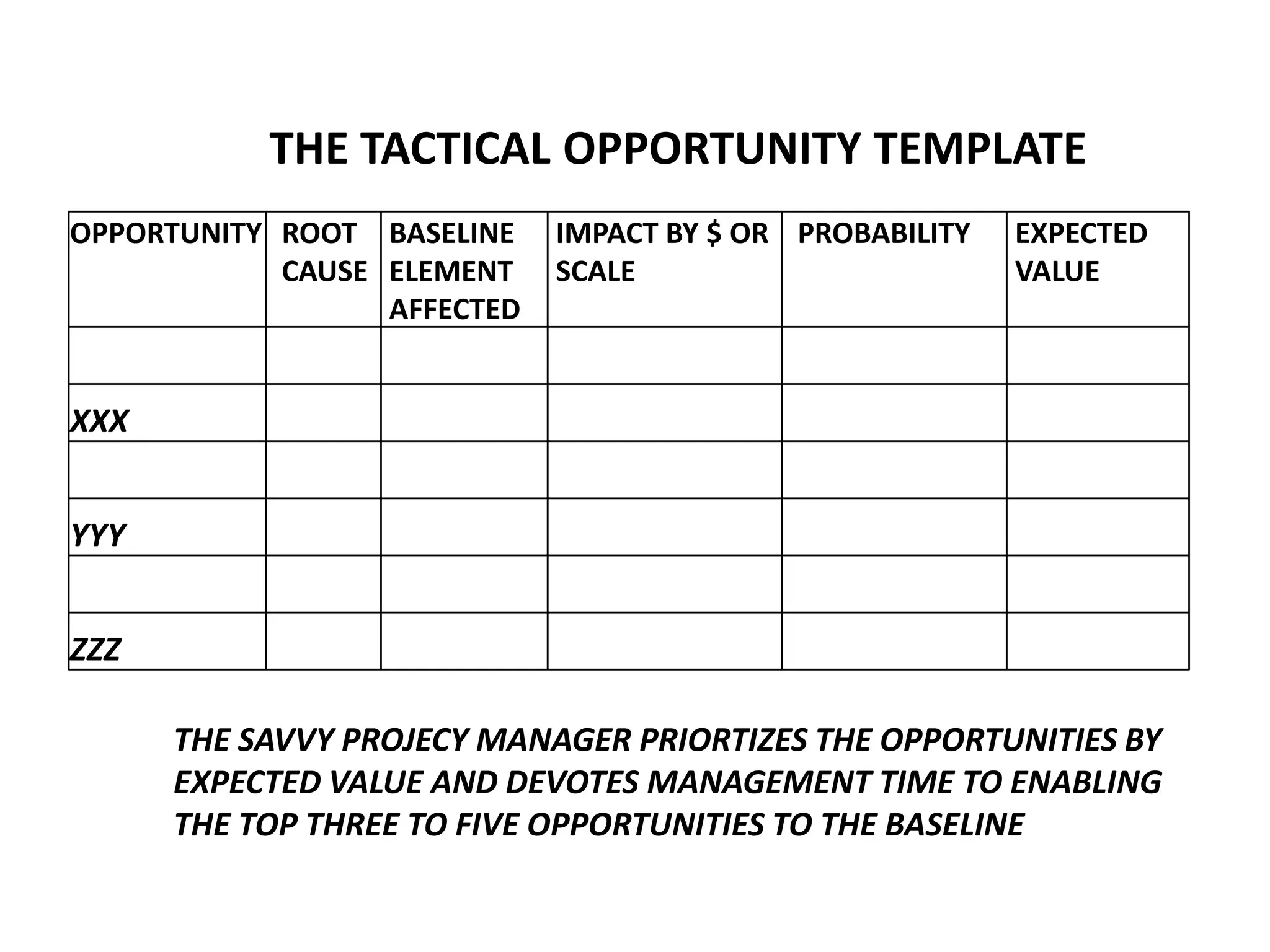

THE TACTICAL OPPORTUNITY TEMPLATE
OPPORTUNITY ROOT BASELINE
CAUSE ELEMENT
AFFECTED

IMPACT BY $ OR PROBABILITY
SCALE

EXPECTED
VALUE

XXX

YYY
ZZZ
THE SAVVY PROJECY MANAGER PRIORTIZES THE OPPORTUNITIES BY
EXPECTED VALUE AND DEVOTES MANAGEMENT TIME TO ENABLING
THE TOP THREE TO FIVE OPPORTUNITIES TO THE BASELINE

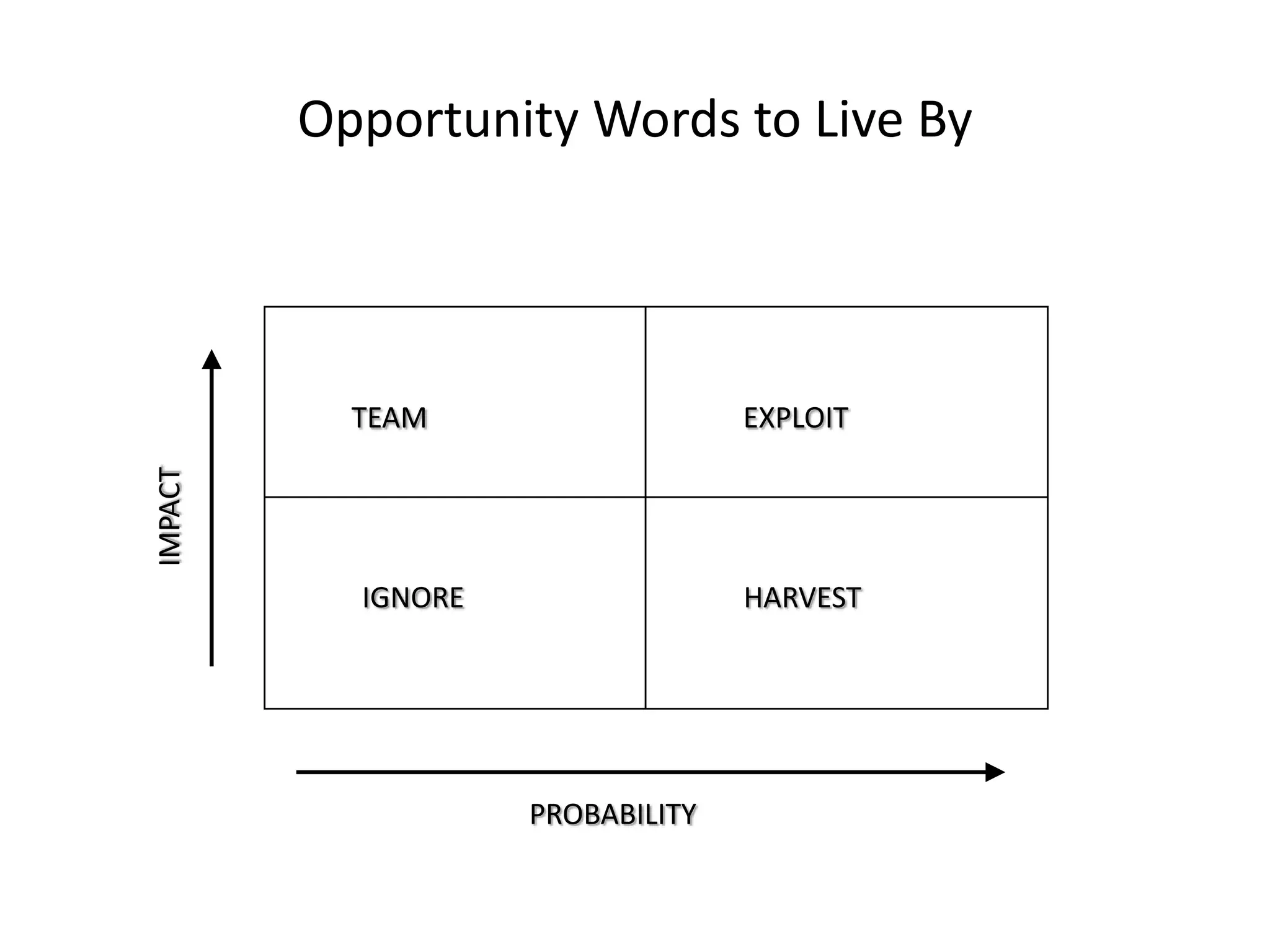

Opportunity Words to Live By

EXPLOIT

IMPACT

TEAM

IGNORE

HARVEST

PROBABILITY

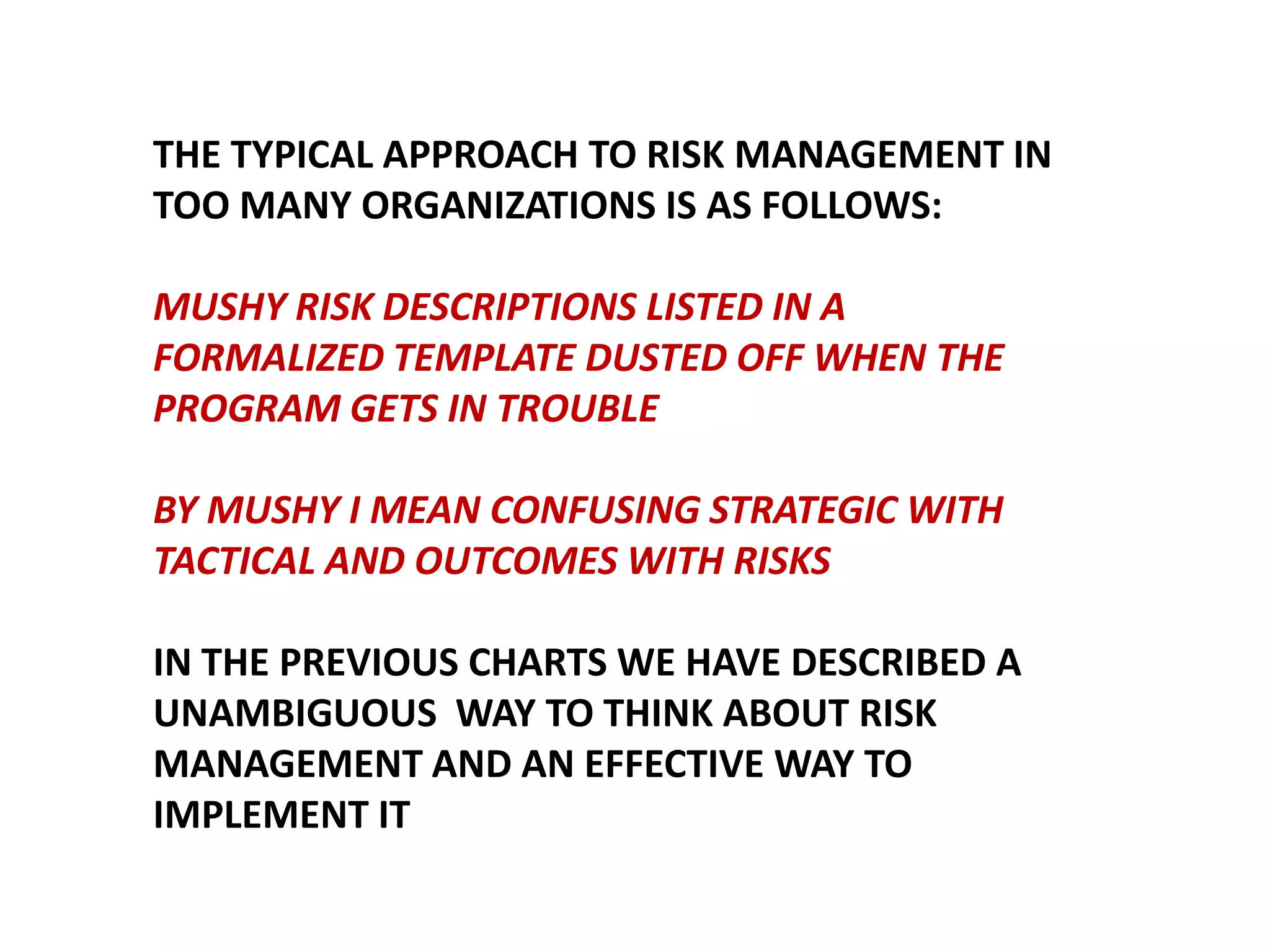

THE TYPICAL APPROACH TO RISK MANAGEMENT IN
TOO MANY ORGANIZATIONS IS AS FOLLOWS:

MUSHY RISK DESCRIPTIONS LISTED IN A
FORMALIZED TEMPLATE DUSTED OFF WHEN THE
PROGRAM GETS IN TROUBLE
BY MUSHY I MEAN CONFUSING STRATEGIC WITH
TACTICAL AND OUTCOMES WITH RISKS
IN THE PREVIOUS CHARTS WE HAVE DESCRIBED A
UNAMBIGUOUS WAY TO THINK ABOUT RISK
MANAGEMENT AND AN EFFECTIVE WAY TO
IMPLEMENT IT
MY CURRENT AVOCATION IS TEACHING PROJECT MANAGEMENT
AND FACILITATING DISCUSSIONS ABOUT ITS APPLICATION. I’D BE
INTERESTED IN YOUR IDEAS FOR PROTECTING YOUR PROJECT FROM
UNCERTAINTY. PLEASE CONTACT ME ON LINKEDIN OR AT THE EMAIL
BELOW

Dr John Hogan
jhogan1278@gmail.com

Risks and Opps Management- Lip Service or Real

  • 1.
    RISK MANAGEMENT LIP SERVICEOR A PRACTICAL TOOL FOR PROJECT SUCCESS BY DR JOHN HOGAN PMP
  • 2.
    PROJECT MANAGEMENT ISCOMPOSED OF PLANNING AND EXECUTION
  • 3.
    BUSINESS MANAGEMENT ISCOMPOSED OF PLANNING -A PROCESS UNDERTAKEN TO PREDICT THE FUTURE AND EXECUTION
  • 4.
    BUSINESS MANAGEMENT ISCOMPOSED OF PLANNING -A PROCESS UNDERTAKEN TO PREDICT THE FUTURE AND EXECUTION -COMPLETING TASKS THAT WERE DEFINED IN THE PAST
  • 5.
    DOES ANYONE SEEA PROBLEM HERE?
  • 6.
  • 7.
    WE HAVE THEPLANNING FALLACY (COINED BY NOBEL PRIZE WINNER DANIEL KAHNEMAN IN HIS 2011 BEST SELLER THINKING FAST AND SLOW) PROJECT TEAMS ARE EMOTIONALLY AND POLITICALLY DRAWN TO PORTRAYING THE BEST CASE SCENARIO FOR THEIR COST AND SCHEDULE PERFORMANCE AS THE MOST LIKELY (THE INSIDE VIEW) WHILE IGNORING THE PERFORMANCE DATA FROM ALL OTHER PROJECTS IN THEIR REFERENCE CLASS (THE OUTSIDE VIEW)
  • 8.
    WE HAVE COMPLEXITY (SEEA LEADER’S FRAMEWORK FOR DECISION MAKING BY DAVID J. SNOWDEN AND MARY E. BOONE IN THE 2007 HARVARD BUSINESS REVIEW) PROJECT MANAGEMENT BY ITS DEFINITION RESULTS IN UNIQUE PRODUCTS OR SERVICES-PRODUCTS OR SERVICES THAT PREVIOUSLY DID NOT EXIST IF THESE PRODUCTS OR SERVICES INTERACT WITH OTHER COMPONENTS, ALREADY DEVELOPED OR IN DEVELOPMENT, THE PROACTIVE PROJECT MANAGER MUST BE AWARE OF THESE INTERACTIONS SELF-ORGANIZING BEHAVIORS CAN EMERGE THAT HAVE AN UNPREDICTABLE IMPACT ON A PROJECT’S COST, SCHEDULE, OR FUNCTIONALITY
  • 9.
    WE HAVE LIMITEDKNOWLEDGE (SEE THE BLACK SWAN BY NASSIM TALEB FOR A LUCID ANALYSIS OF THE IMPACT OF RARE EVENTS) A STATISTICALLY MINDED TURKEY MAY THINK IT HAS KNOWLEDGE OF ITS EXPECTED DAILY GRAIN RATION BASED OF A YEAR OF DATA. IT KNOWS THE MEAN AND THE STANDARD DEVIATION BUT IT DOSEN’T KNOW NEXT WEEK IS THANKSGIVING
  • 10.
    IN SHORT WEHAVE UNCERTAINTY “UNCERTAINTY IS TOMORROW’S ONLY TRUTH” LORENZO OF FLORENCE, CIRCA 1500
  • 11.
  • 12.
    ALTHOUGH HUMANS CANNOT PREDICTTHE FUTURE WE STILL HAVE TO KEEP OUR STAKEHOLDERS HAPPY
  • 13.
    ALTHOUGH HUMANS CANNOT PREDICTTHE FUTURE WE STILL HAVE TO KEEP OUR STAKEHOLDERS HAPPY BY COMMITTING TO BASELINES
  • 14.
    IN THE PLANNINGPHASE WE JUGGLE THE BALLS OF FUNCTIONALITY COST AND SCHEDULE UNTIL WE HAVE AN EXECUTABLE BASELINE -at least we think it is BASELINE
  • 15.
    HOWEVER THIS BASELINEIS NO MORE THAN THE CONCENSUS OPINION (AMOUNG OURSELVES AND OUR STAKEHOLDERS) OF WHAT THE FUTURE WILL BE
  • 16.
    THE STAKEHOLDERS WATCHUS AND OFFER THEIR OPINION ON OUR ABILITY TO BUILD THIS BASELINE Nice job Very thorough BASELINE Nice suit Can I leave now
  • 17.
    THE FUTURE COMESSOONER THAN WE THINK AND IN THE EXECUTION PHASE JUGGLING BALLS TURNS INTO JUGGLING CHAINSAWS AND THE TERRA FIRMA OF THE PLAN YEILDS TO UNCERTAINTY -you’re a little more interesting to watch now SCHEDULE SCOPE COST
  • 18.
    AND NOW THESTAKEHOLDERS BECOME MORE ANIMATED SCHEDULE SCOPE COST Who decided that What were you thinking That’s gonna cost us Where’s the risk management been on this project
  • 19.
    RISK MANAGEMENT ISA FORMAL ATTEMPT AT PROTECTING OUR BASELINES FROM THE PERILS OF UNCERTAINTY
  • 20.
    RISK MANAGEMENT HASTWO FORMS STRATEGIC APPLIED DURING THE PLANNING PROCESS TO ENSURE THE BASELINE HAS A BALANCE OF RISKS AND OPPORTUNITIES ALIGNED WITH THE ORGANIZATIONAL MISSION TACTICAL APPLIED DURING PROJECT EXECUTION TO ENSURE THE BASELINED FUNCTIONALITY IS DELIVERED ON TIME AND WITHIN BUDGET
  • 21.
    THE UNDERLYING PROCESSFOR QUANTIFYING RISKS OR OPPORTUNITIES IS BASED ON THE CONCEPT OF EXPECTED VALUE (DEVELOPED BY MEMBERS OF THE BERNOULLI FAMILY-CIRCA 1700s) EXPECTED VALUE = IMPACT times PROBABILITY
  • 22.
    STRATEGIC RISK APPLIED INTHE PLANNING PHASE MUST ADDRESS COMPETITIVE MARKET PLACE FORCES DRIVEN BY THE ORGANIZATIONAL CULTURE RISK ADVERSE OR RISK TAKING SUPPORTING TOOLS RANGE FROM SWOT ANALYSIS TO DECISION TREES TO PROPRIETARY ANALYTIC ALGORITHMS BUT CULTURE TRUMPS TOOLS
  • 23.
    NO MATTER WHATTHE NATURE OF OUR ORGANIZATION’S RISK CULTURE…… IF WE LEAVE THE STRATEGIC PLANNING PHASE WITH A PROJECT………. WE LEAVE WITH A BASELINE
  • 24.
    RISK BASELINE SOME RISKS ARERETIRED IN BASELINE DECISIONS SOME ARE ACCEPTED IN BASELINE DECISIONS BECAUSE OF THE OPPORTUNITIES THEY ALLOW
  • 25.
    Risk Management OccursDuring Planning (Strategic) and Execution (Tactical) RISK RISK SOME AREN’T BASELINE WHILE SOME RISKS ARE RETIRED IN BASELINE DECISIONS A RISK TEMPLATE IS USED AS A MANAGEMENT TOOL DURING PROJECT EXECUTION
  • 26.
    BEFORE WE ADDRESSTACTICAL RISK MITIGATION LET’S ADDRESS A MAJOR MISUNDERSTANDING CONFUSING OUTCOMES WITH RISKS IF A PROJECT MANAGER RELATES THE FOLLOWING “I HAVE A MAJOR RISK. I THINK THE SOFTWARE DEVELOPMENT MIGHT BE TWO MONTHS LATE AND 20% OVERRUN” WHAT SHOULD THE BOSS SAY?
  • 27.
  • 28.
    NO S!@# SOFTWARE ISALWAYS LATE AND ITS ALWAYS OVERRUN TELL ME SOMETHING I DON’T KNOW
  • 29.
    WE NEED TODETERMINE THE UNDERLYING ROOT CAUSE OF THE DELAY TO HAVE ANY CHANCE OF DEVELOPING AN EFFECTIVE RESPONSE ONE EFFECTIVE APPROACH RELIES ON APPLYING 3 POINT ESTIMATING WHEN BUILDING THE BASELINE FOR KEY COST DRIVERS AND LONG ACTIVITIES ON THE CRITICAL PATH WE ASK THE TEAM MEMBERS PROVIDING THE ESTIMATES FOR THREE NUMBERS BEST CASE MOST LIKELY WORST CASE
  • 30.
    WHEN APPLIED TOALL LINE ITEMS IN THE SCHEDULE THE 3 POINT SYSTEM FORMS THE BASIS OF THE PERT ESTIMATING APPROACH PERT HAS BEEN AROUND SINCE THE FIRST NUCLEAR SUBMARINE WE’RE NOT GOING TO CONCERN OURSELVES WITH PERT HERE. WE’RE STILL GETTING A HANDLE ON TACTICAL RISK
  • 31.
    TACTICAL RISK THE SAVVYRISK MANAGER ASKS THOSE WHO BUILT THE ESTIMATE “WHAT WOULD HAVE TO TRANSPIRE TO MAKE THE WORST CASE OCCUR” “WHAT WOULD HAVE TO TRANSPIRE TO MAKE THE BEST CASE OCCUR” WE NOW HAVE SPECIFIC EVENTS FOR WHICH WE CAN ESTIMATE IMPACT AND PROBABILITY
  • 32.
    Results of Uncertainty POSSIBLEOUTCOMES UNCERTAINTY BEST CASE WORST CASE MOST LIKELY BETTER THAN BASELINED WORSE THAN BASELINED . . HOW DO WE MAKE ACTIONABLE OPPORTUNITY (BEST CASE) RISK (WORST CASE)
  • 33.
    Making Risks Actionable •What undesirable events or conditions from the cloud of uncertainty are the root cause of risks to the baseline • What is the negative impact if these undesirable events or conditions come to pass • What is the probability of these events or conditions coming to pass • What cost effective mitigation can be implemented to reduce the impact or reduce the probability of these risks
  • 34.
    Making Opportunities Actionable •What desirable events or conditions from the cloud of uncertainty are the enablers of opportunities to the baseline • What is the positive impact if these desirable events or conditions come to pass • What is the probability of these events or conditions coming to pass • What cost effective enhancements can be implemented to increase the impact or increase the probability of these opportunities
  • 35.
    RISK/OPPORTUNITY TAXONOMY RISK OPPORTUNITY Undesirable eventsconditions Desirable events conditions Root Cause Enablers Negative Impact Positive Impact Probability Probability Cost Effective Actions Cost Effective Actions Mitigate Risk Enhance Opportunities Reduce Impact Increase Impact Reduce Probability Increase Probability
  • 36.
    THE TACTICAL RISKTEMPLATE RISK ROOT BASELINE CAUSE ELEMENT AFFECTED IMPACT BY $ OR PROBABILITY EXPECTED SCALE VALUE XXX YYY ZZZ THE SAVVY PROJECY MANAGER PRIORTIZES THE RISK EVENTS BY EXPECTED VALUE AND DEVOTES MANAGEMENT TIME TO MITIGATING THE ROOT CAUSES OF THE TOP THREE TO FIVE RISKS TO THE BASELINE
  • 37.
    Risk Words toLive By PREVENT IMPACT INSURE ACCEPT MITIGATE PROBABILITY
  • 38.
    THE TACTICAL OPPORTUNITYTEMPLATE OPPORTUNITY ROOT BASELINE CAUSE ELEMENT AFFECTED IMPACT BY $ OR PROBABILITY SCALE EXPECTED VALUE XXX YYY ZZZ THE SAVVY PROJECY MANAGER PRIORTIZES THE OPPORTUNITIES BY EXPECTED VALUE AND DEVOTES MANAGEMENT TIME TO ENABLING THE TOP THREE TO FIVE OPPORTUNITIES TO THE BASELINE
  • 39.
    Opportunity Words toLive By EXPLOIT IMPACT TEAM IGNORE HARVEST PROBABILITY
  • 40.
    THE TYPICAL APPROACHTO RISK MANAGEMENT IN TOO MANY ORGANIZATIONS IS AS FOLLOWS: MUSHY RISK DESCRIPTIONS LISTED IN A FORMALIZED TEMPLATE DUSTED OFF WHEN THE PROGRAM GETS IN TROUBLE BY MUSHY I MEAN CONFUSING STRATEGIC WITH TACTICAL AND OUTCOMES WITH RISKS IN THE PREVIOUS CHARTS WE HAVE DESCRIBED A UNAMBIGUOUS WAY TO THINK ABOUT RISK MANAGEMENT AND AN EFFECTIVE WAY TO IMPLEMENT IT
  • 41.
    MY CURRENT AVOCATIONIS TEACHING PROJECT MANAGEMENT AND FACILITATING DISCUSSIONS ABOUT ITS APPLICATION. I’D BE INTERESTED IN YOUR IDEAS FOR PROTECTING YOUR PROJECT FROM UNCERTAINTY. PLEASE CONTACT ME ON LINKEDIN OR AT THE EMAIL BELOW Dr John Hogan jhogan1278@gmail.com

Editor's Notes

  • #8 FOR EXAMPLETHE AVERAGE COST/SCHEDULE OVERRUN FOR THE 98 MAJOR DEFENSE ACQUISITION PROGRAMS IS $40B/22 MONTHS YET, EACH NEW DoD PROJECT TEAM BELIEVES (AND CONVINCES CONGRESS) THEIR INITIATIVE WILL BE DIFFERENT
  • #9 FOR EXAMPLETHE JAVA PROGRAMMING LANGUAGE WAS ORIGINALLY TARGETED FOR INTERACTIVE TV. THE DIGITAL CABLE INDUSTRY AT THAT TIME WAS NOT ABLE TO APPLY THIS TECHNOLOGY, BUT THE NEWLY EMERGING INTERNET WAS. THE NETSCAPE
  • #11 Unknown customerUnknown team leadershipNew technologyTeam dynamicsScope creepChanging financial landscape (external or internal)Bid assumptionsOrganizational changesDynamic user needsUser interaction with productChanging legal/regulatory landscapeChanging competitive landscapeChanging technology landscapeAttritionProbabilistic requirements
  • #14 SCOPE COST SCHEDULE
