Intaver Institute Inc.
Analysis of Risk Resilient Project
Portfolios
Presented at
Society of Risk Analysis World Congress on Risk
Cape Town, May 2019
Intaver Institute Inc.

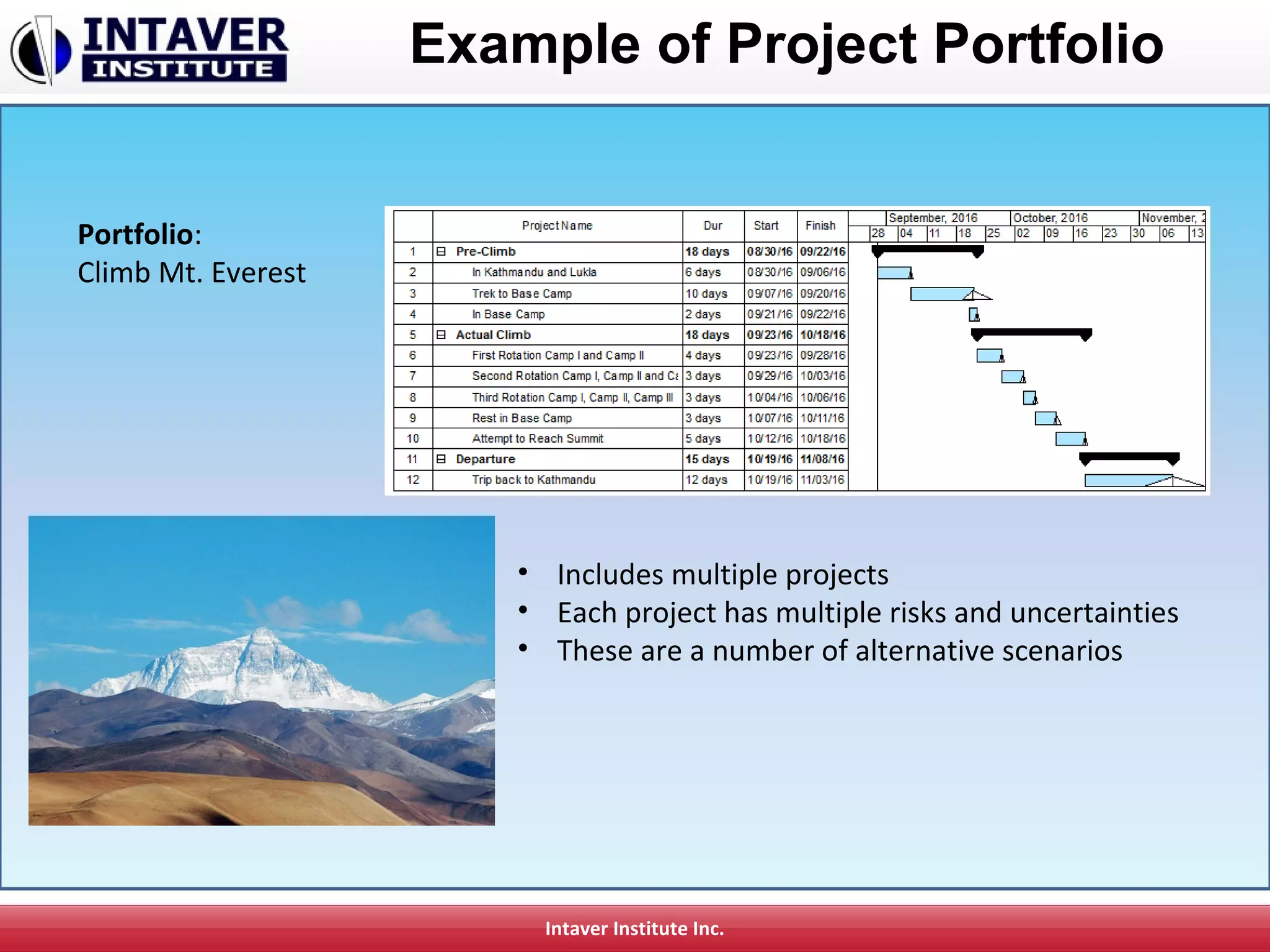

Example of Project Portfolio
Portfolio:
Climb Mt. Everest
• Includes multiple projects
• Each project has multiple risks and uncertainties
• These are a number of alternative scenarios
Intaver Institute Inc.

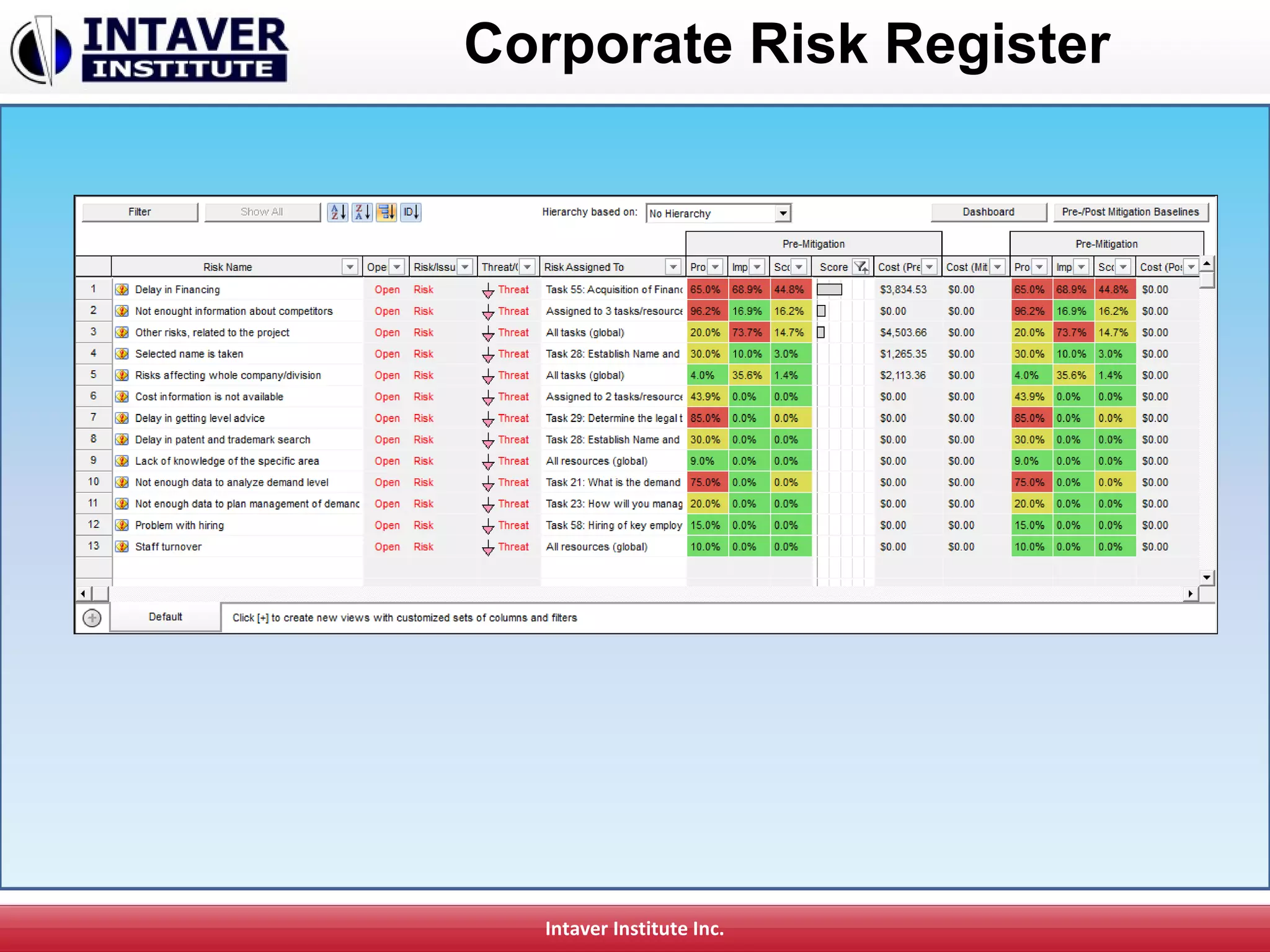

Corporate Risk Register
Intaver Institute Inc.

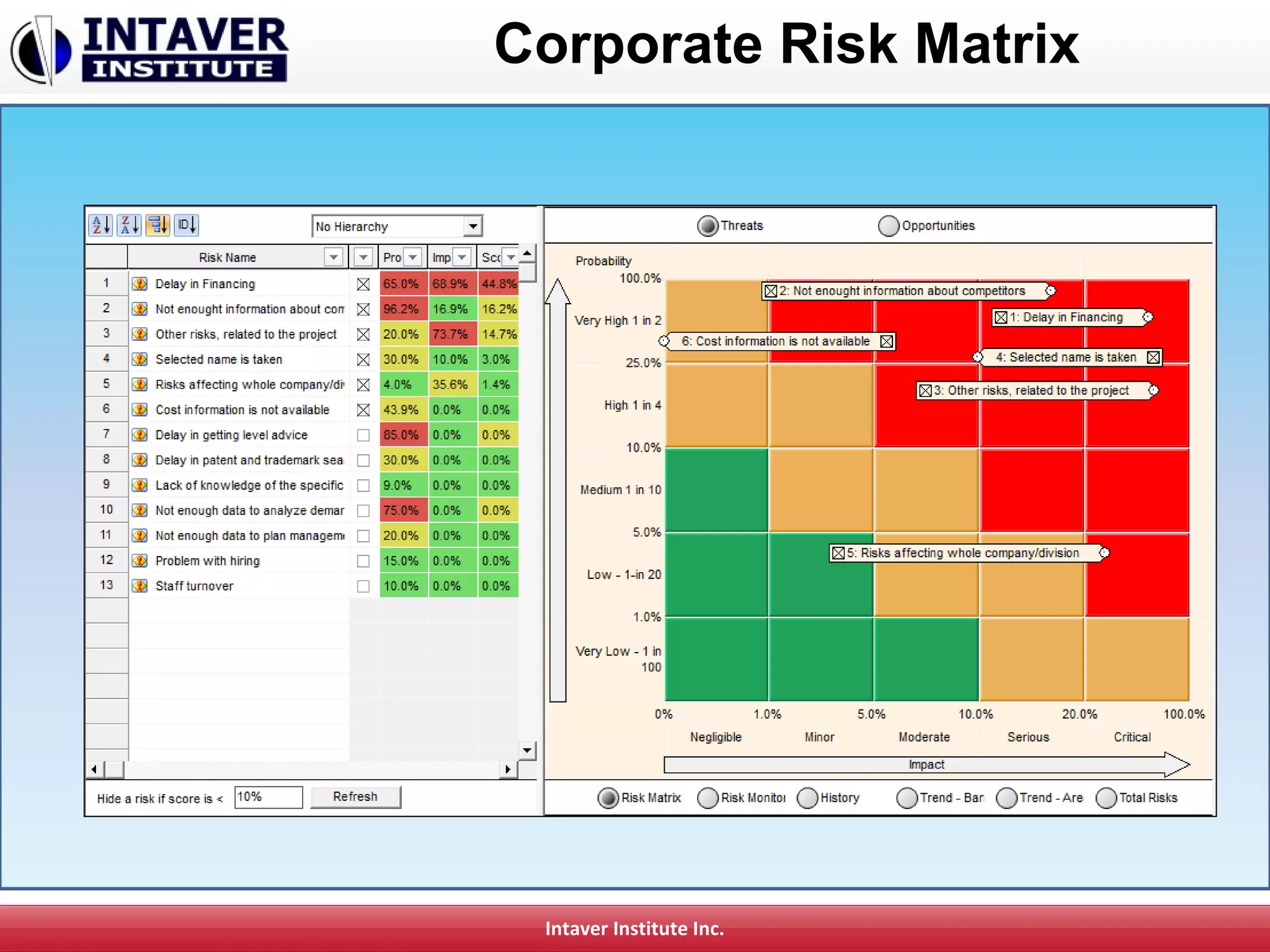

Corporate Risk Matrix
Intaver Institute Inc.

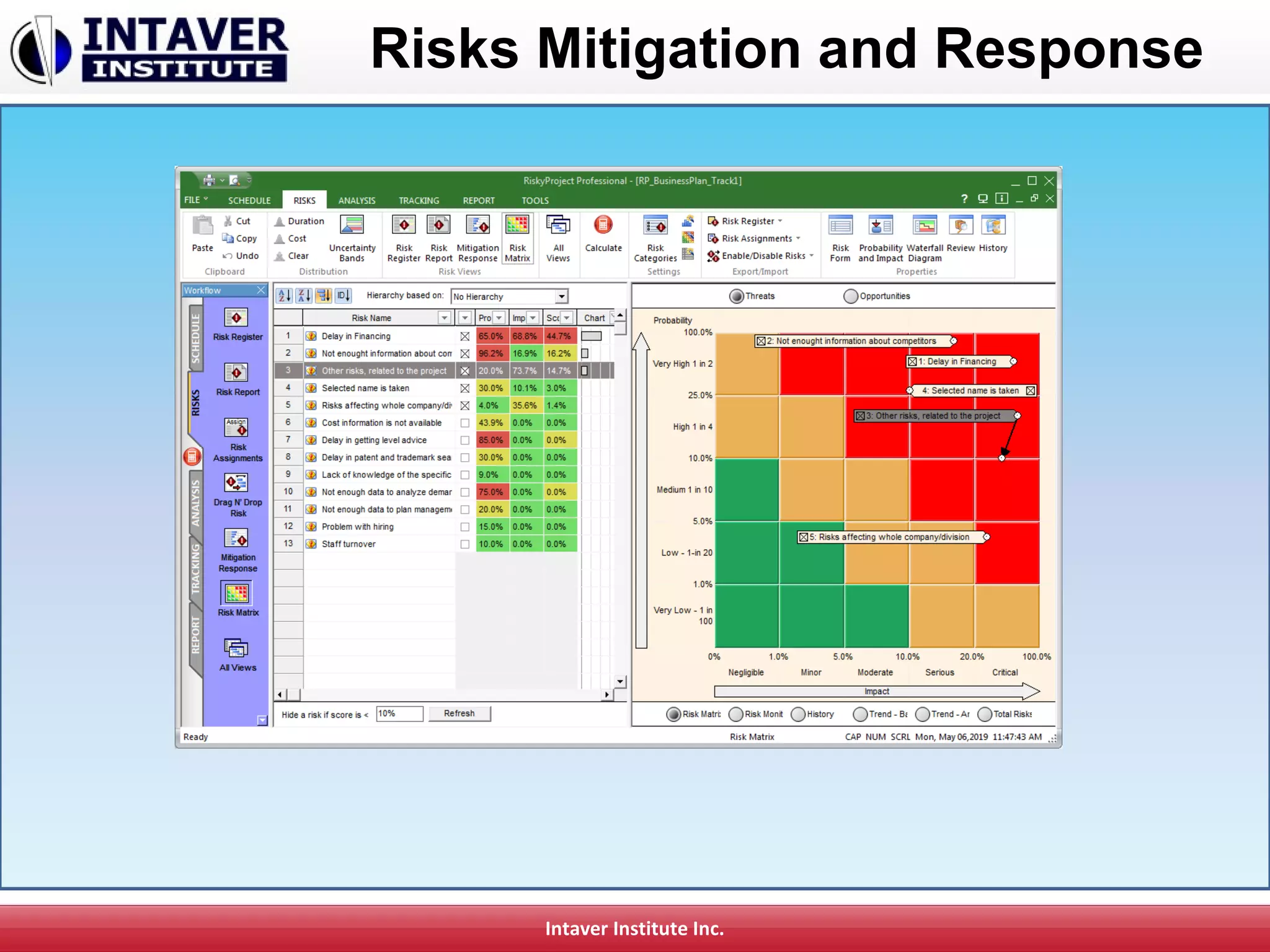

Risks Mitigation and Response
Intaver Institute Inc.

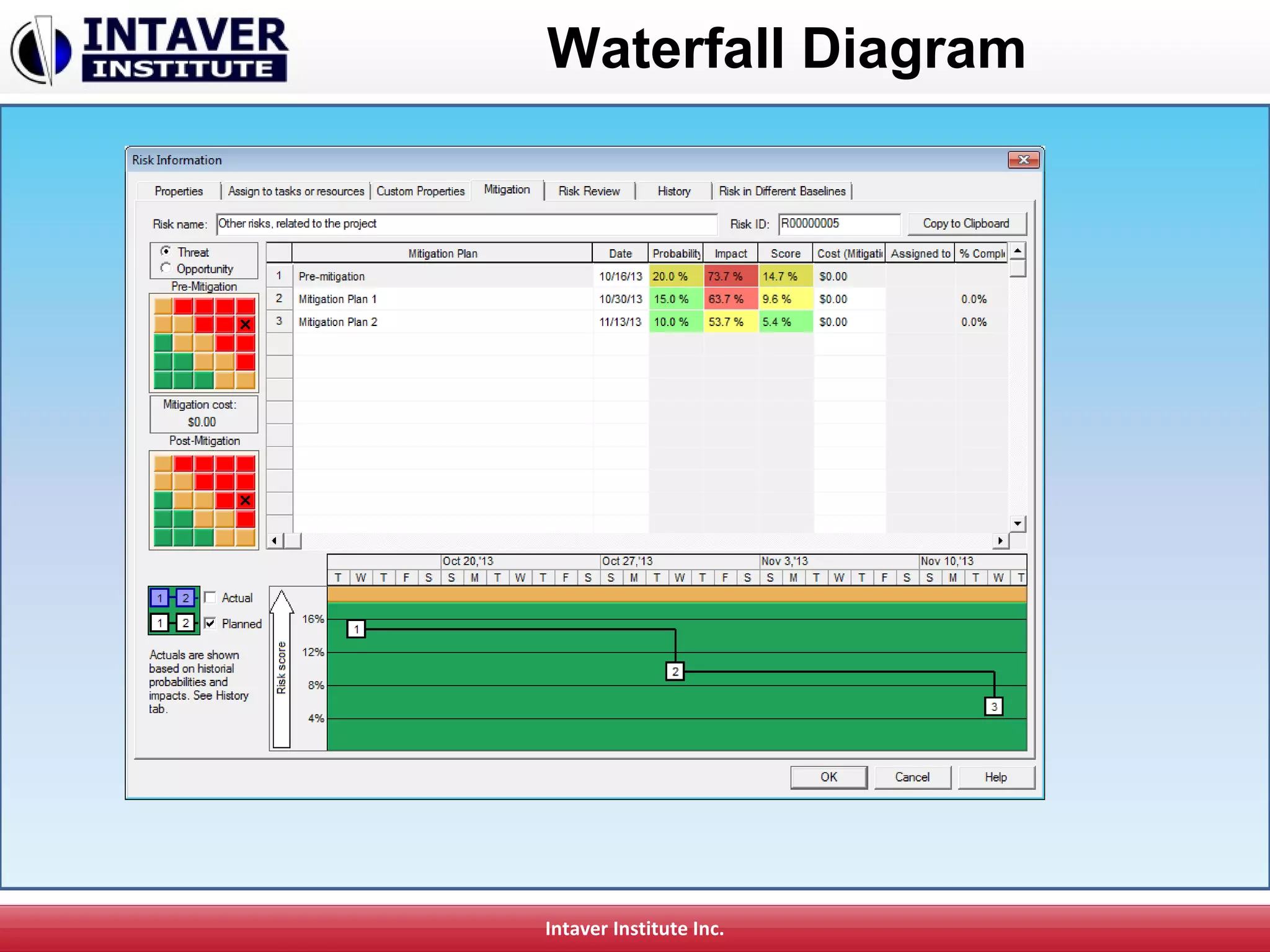

Waterfall Diagram
Intaver Institute Inc.

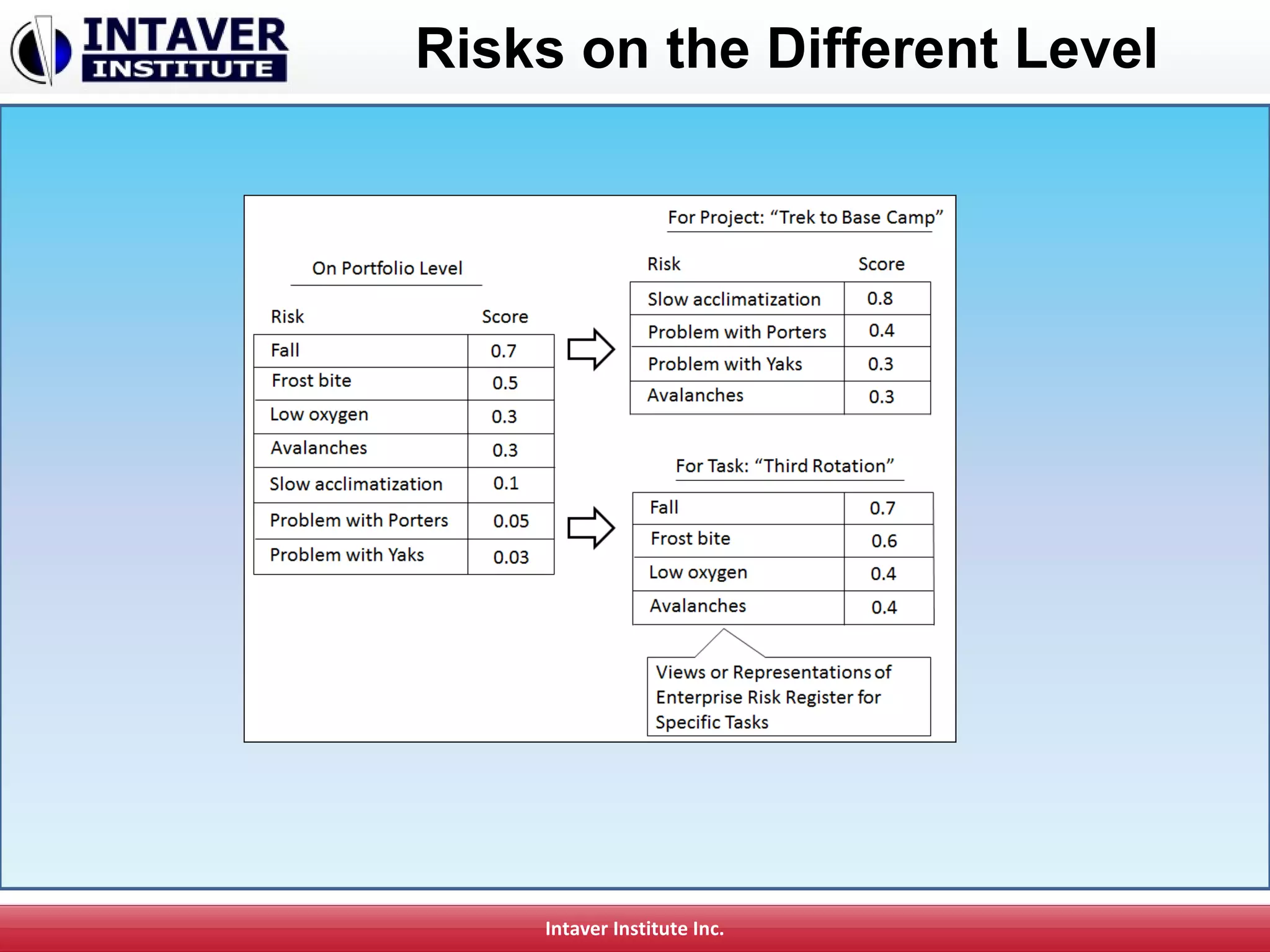

Risks on the Different Level
Intaver Institute Inc.

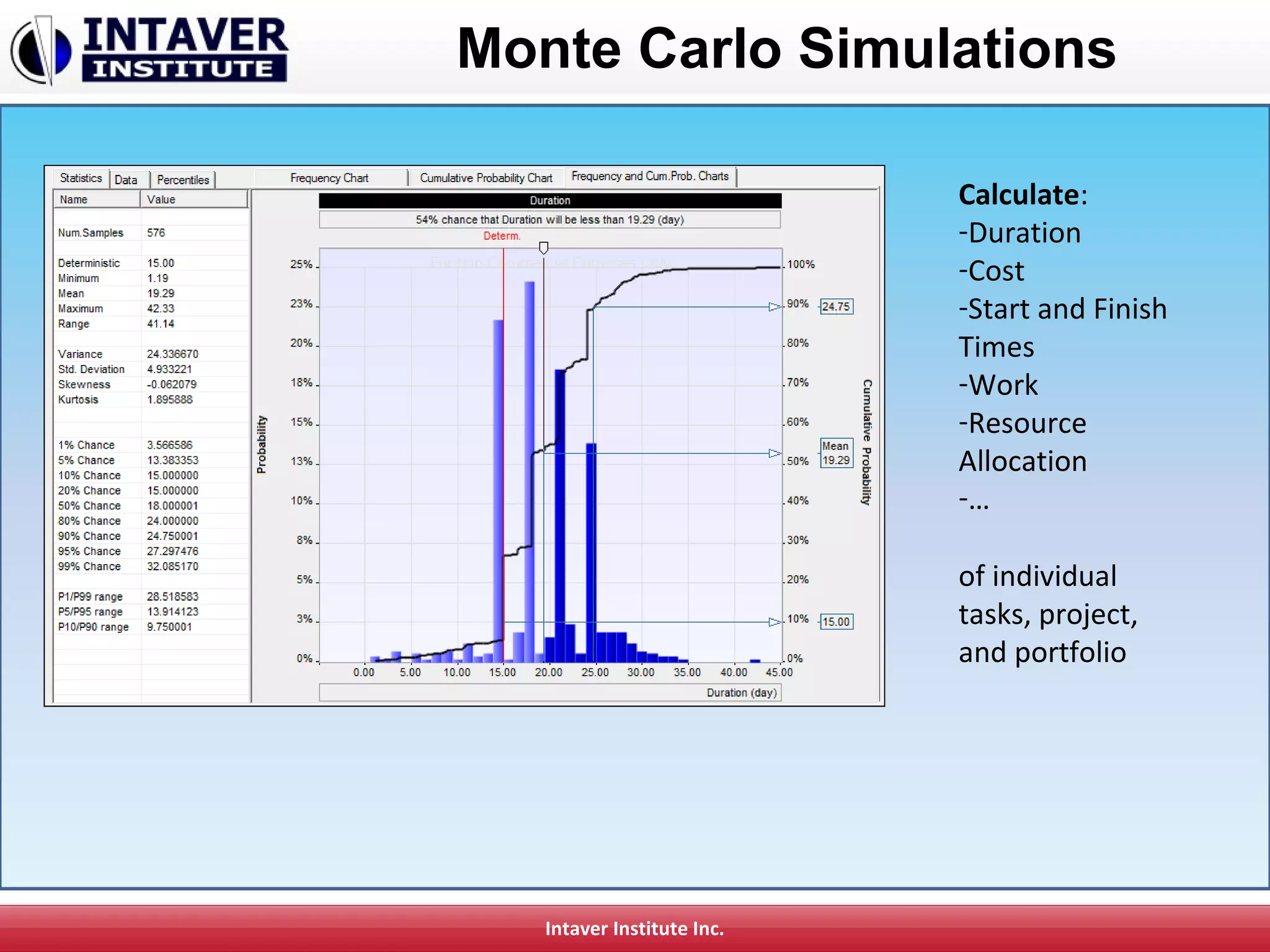

Monte Carlo Simulations
Calculate:
-Duration
-Cost
-Start and Finish
Times
-Work
-Resource
Allocation
-…
of individual
tasks, project,
and portfolio
Intaver Institute Inc.

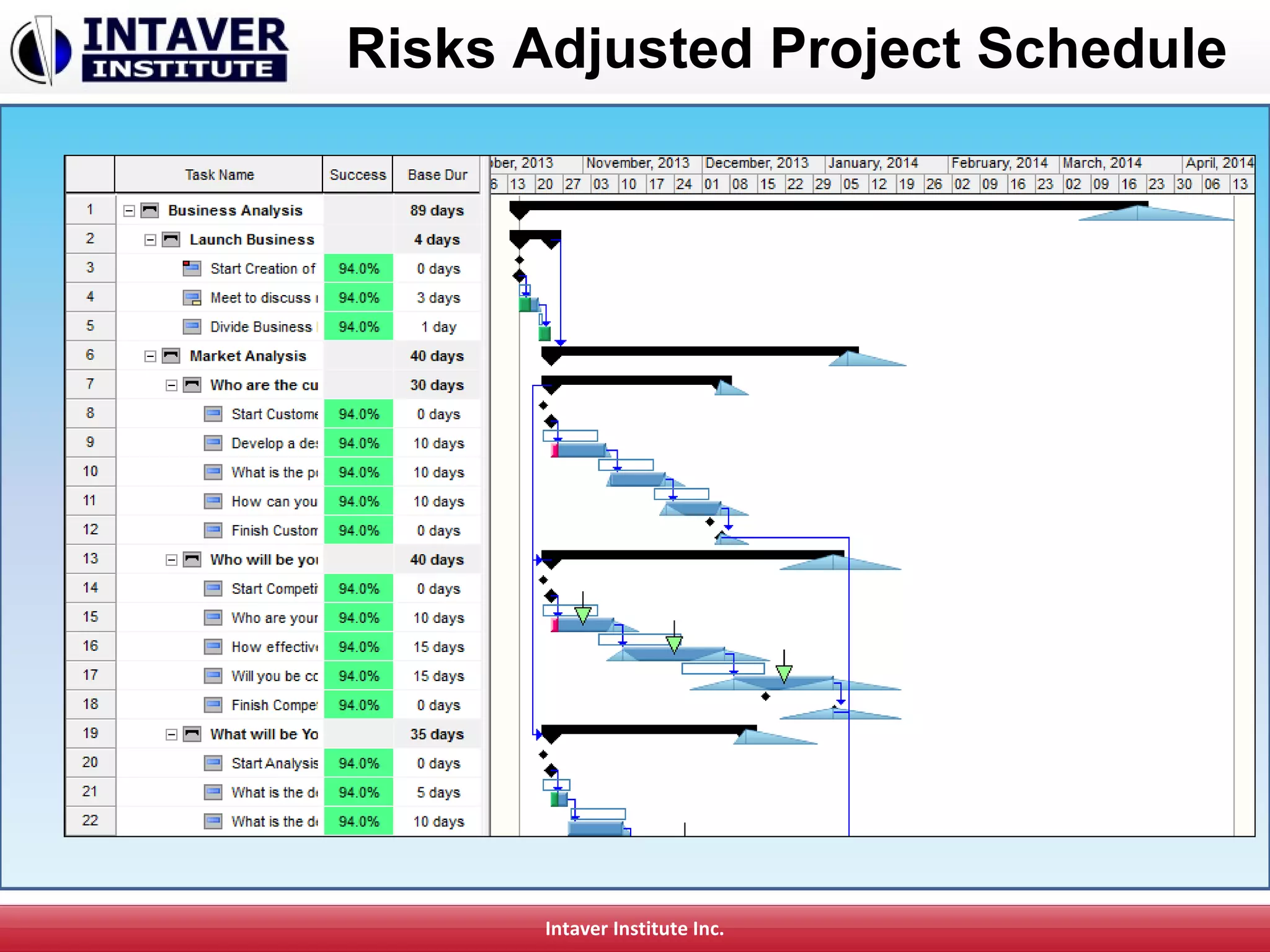

Risks Adjusted Project Schedule
19-05-07 Intaver Institute Inc. 10

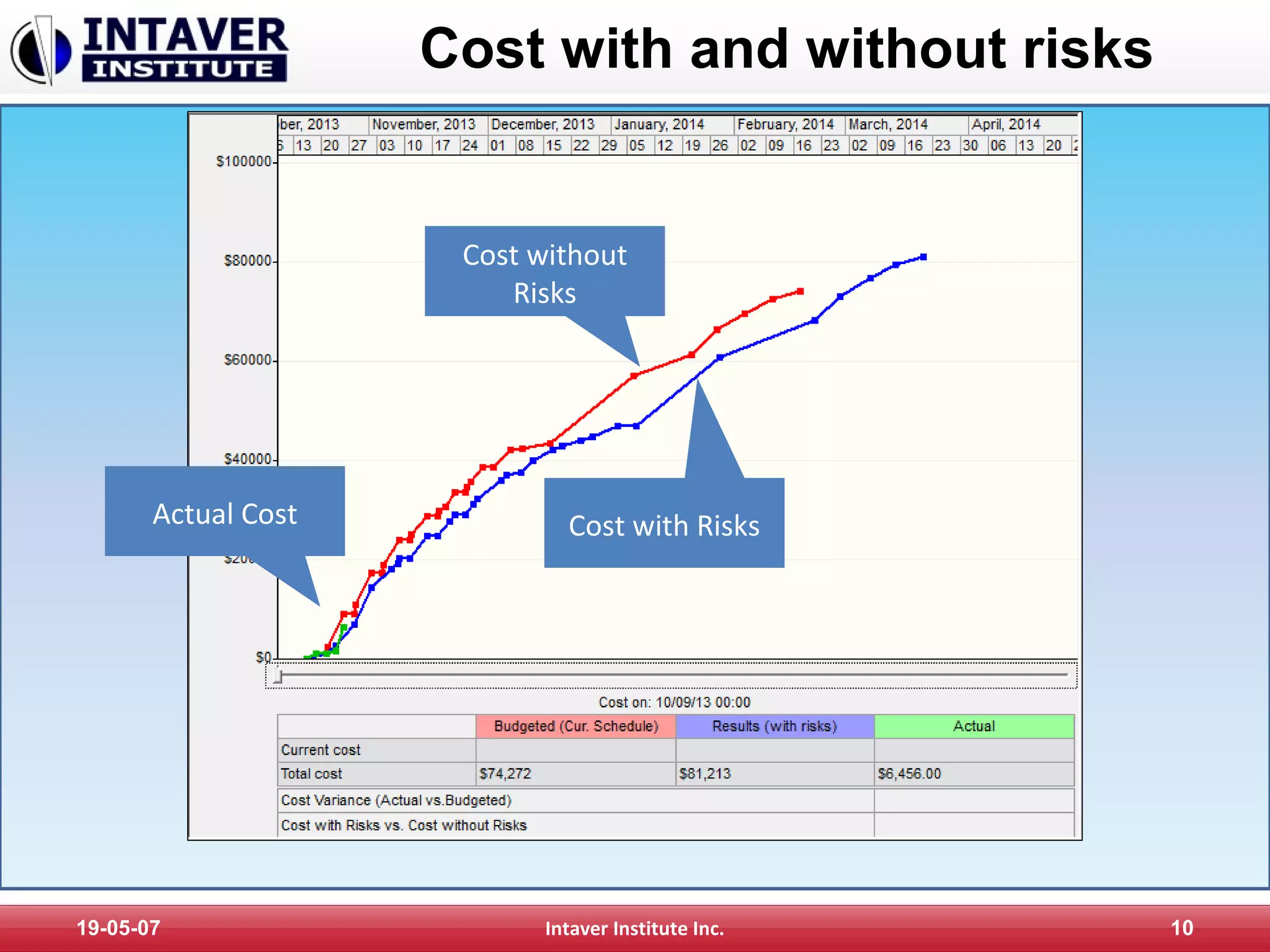

Cost with and without risks
Actual Cost
Cost without
Risks
Cost with Risks
Intaver Institute Inc.

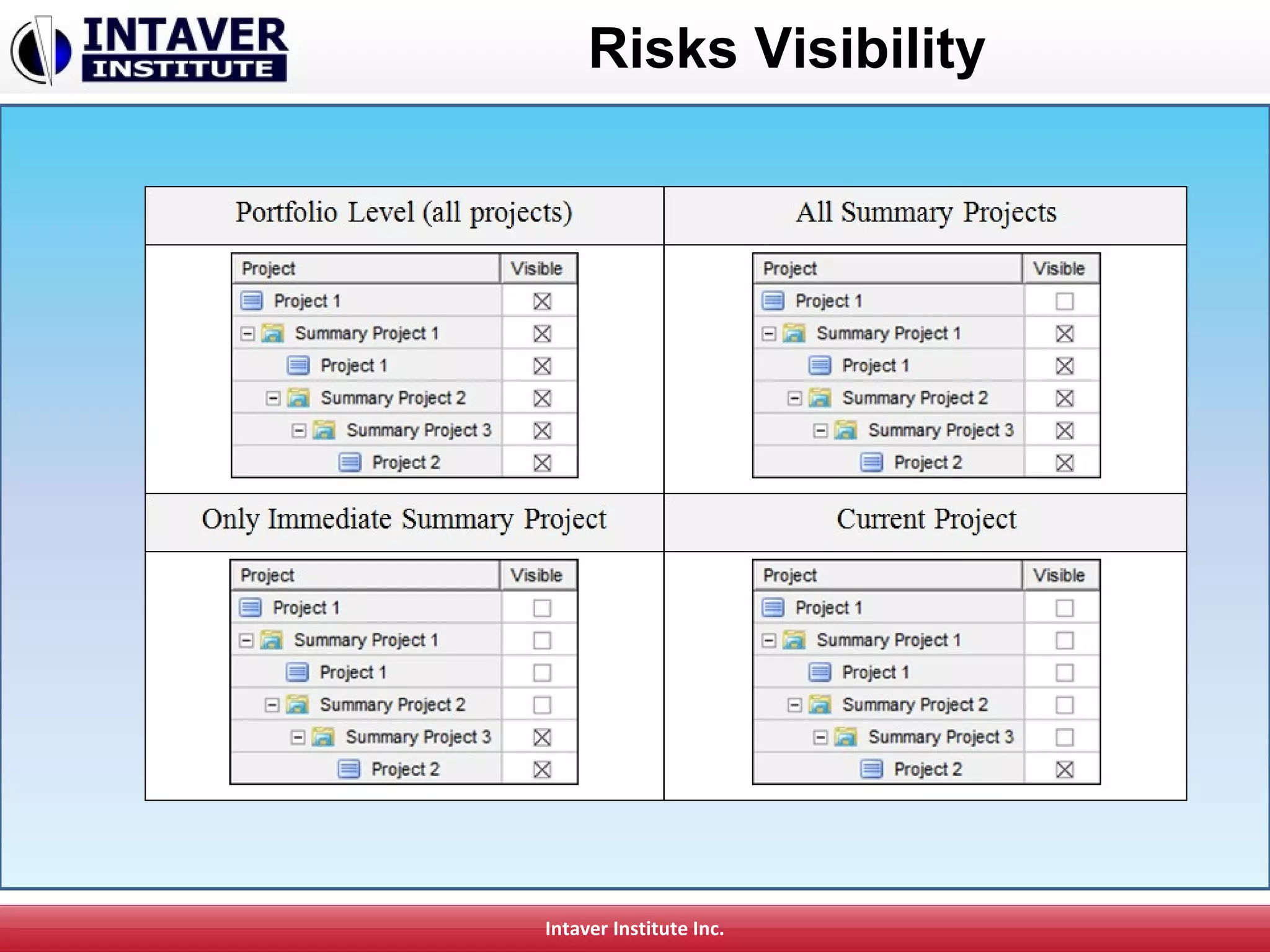

Risks Visibility
Intaver Institute Inc.
Project Prioritization Based on Risks
Intaver Institute Inc.

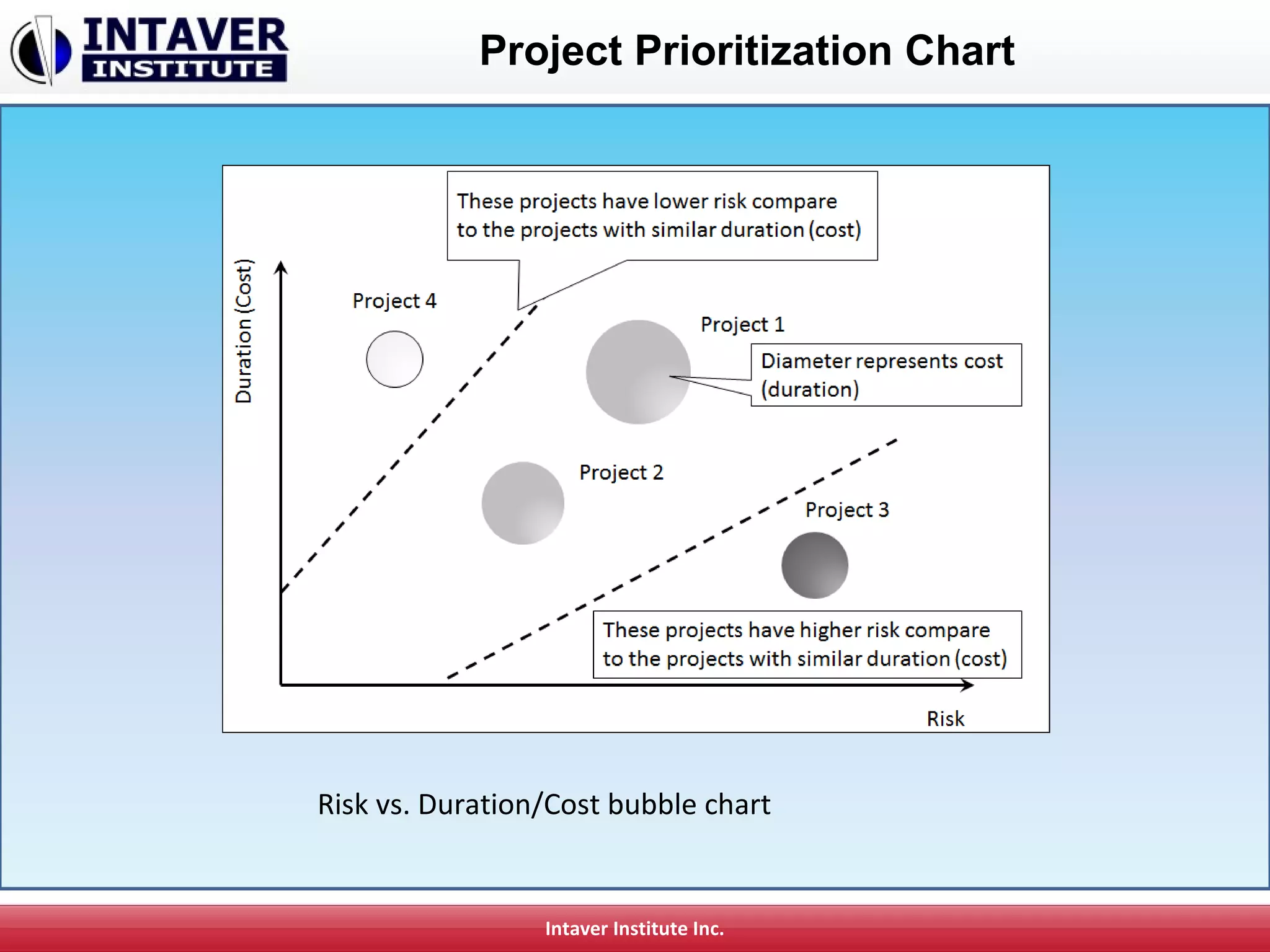

Project Prioritization Chart
Risk vs. Duration/Cost bubble chart
Intaver Institute Inc.

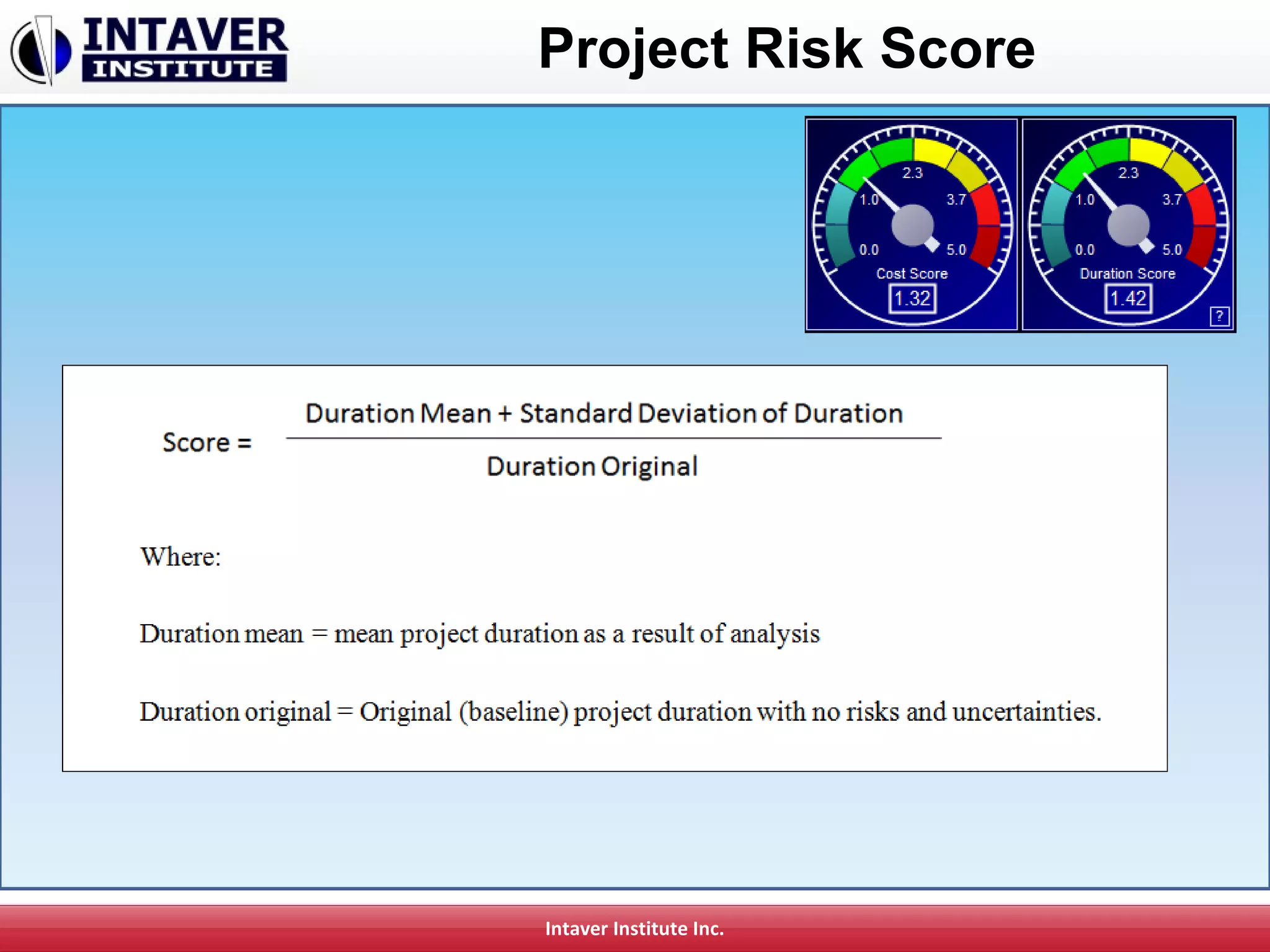

Project Risk Score
Intaver Institute Inc.

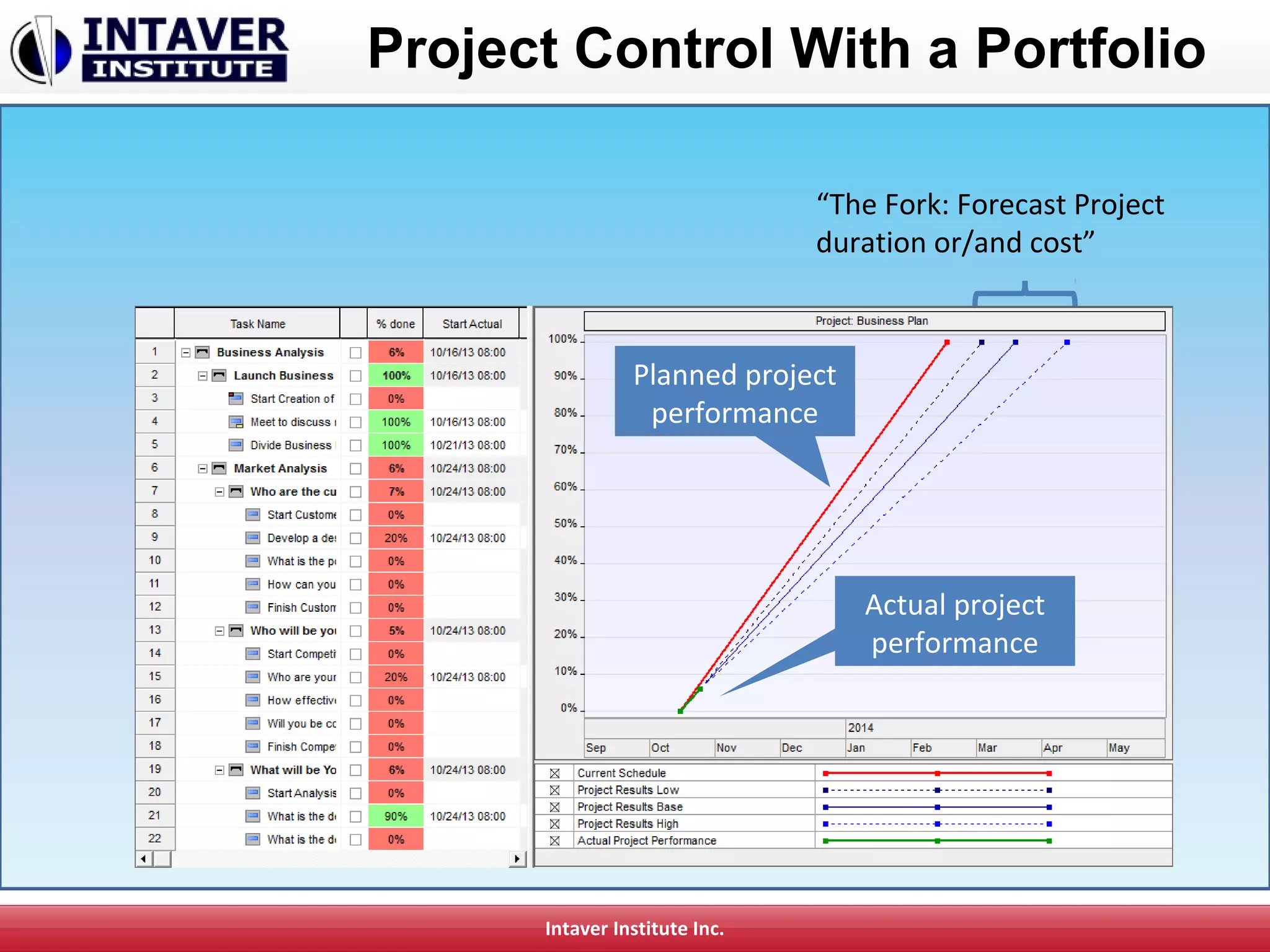

Project Control With a Portfolio
“The Fork: Forecast Project
duration or/and cost”
Planned project
performance
Actual project
performance
Intaver Institute Inc. 16
Additional Resources
Project Think:
Why Good Managers Make Poor
Project Choices
Project Decisions: The Art and Science
Introduction to Project Risk
Management and Decision Analysis
Project Risk Analysis Made Ridiculously
Simple
A Step by Step Guide to Project Risk
Analysis
Intaver Institute Inc
www.intaver.com
Information about books and
technology
www.projectdecisions.org

Risk Resilient Projects and Project Portfolios
