Adaptive Management
Intaver Institute Inc.
303, 6707, Elbow Drive S.W, Calgary, AB, Canada
Tel: +1(403)692-2252
Fax: +1(403)459-4533
www.intaver.com
Power of Adaptation
Will Polar Bears Be Extinct Because of
Global Warming?
Hopefully not, as
they are capable of
adapting to
changing conditions

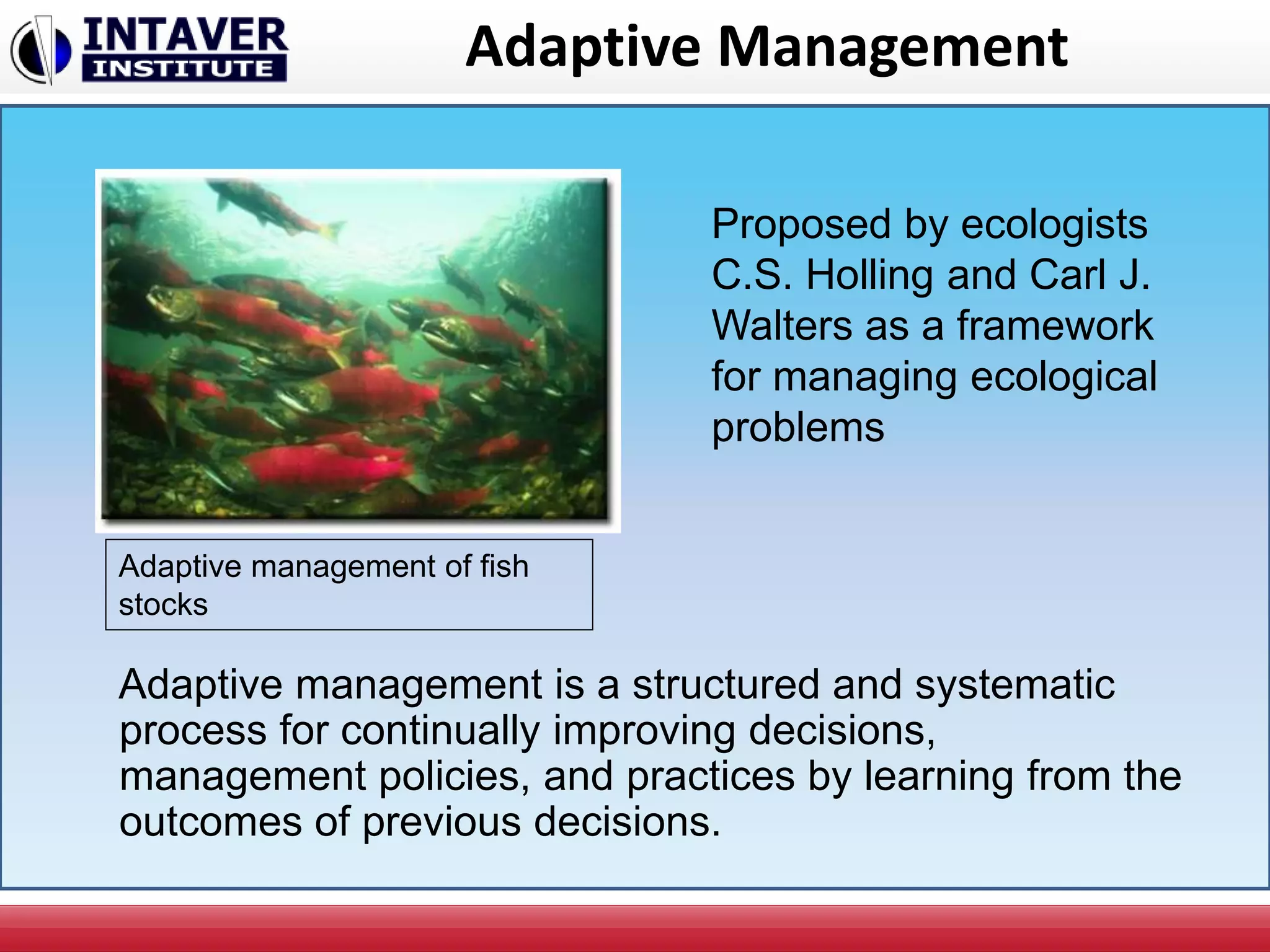

Adaptive Management
Adaptive management is a structured and systematic
process for continually improving decisions,
management policies, and practices by learning from the
outcomes of previous decisions.
Proposed by ecologists
C.S. Holling and Carl J.
Walters as a framework
for managing ecological
problems
Adaptive management of fish
stocks

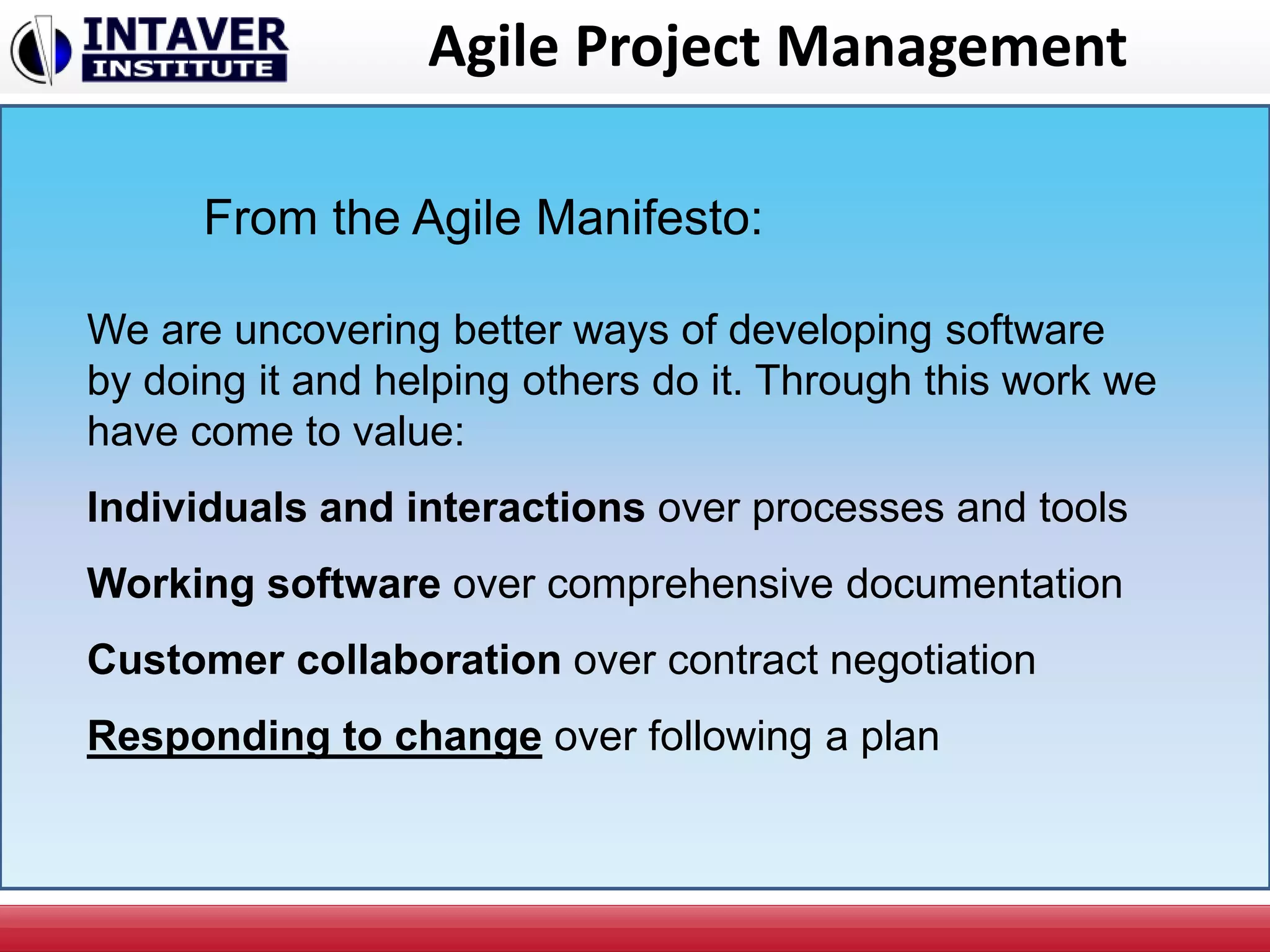

Agile Project Management
We are uncovering better ways of developing software
by doing it and helping others do it. Through this work we
have come to value:
Individuals and interactions over processes and tools
Working software over comprehensive documentation
Customer collaboration over contract negotiation
Responding to change over following a plan
From the Agile Manifesto:

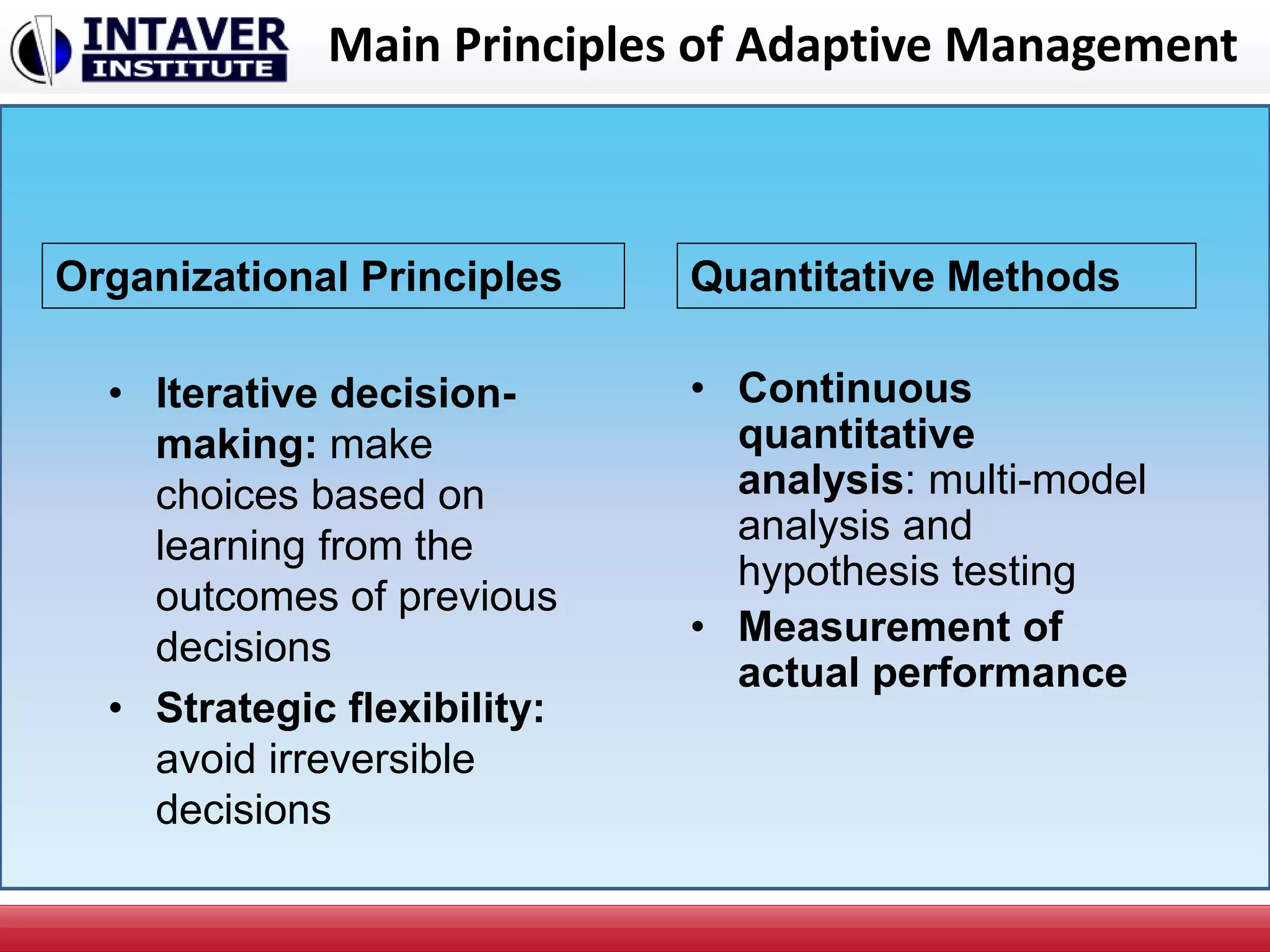

Main Principles of Adaptive Management
• Iterative decision-
making: make
choices based on
learning from the
outcomes of previous
decisions
• Strategic flexibility:
avoid irreversible
decisions
• Continuous
quantitative
analysis: multi-model
analysis and
hypothesis testing
• Measurement of
actual performance
Organizational Principles Quantitative Methods

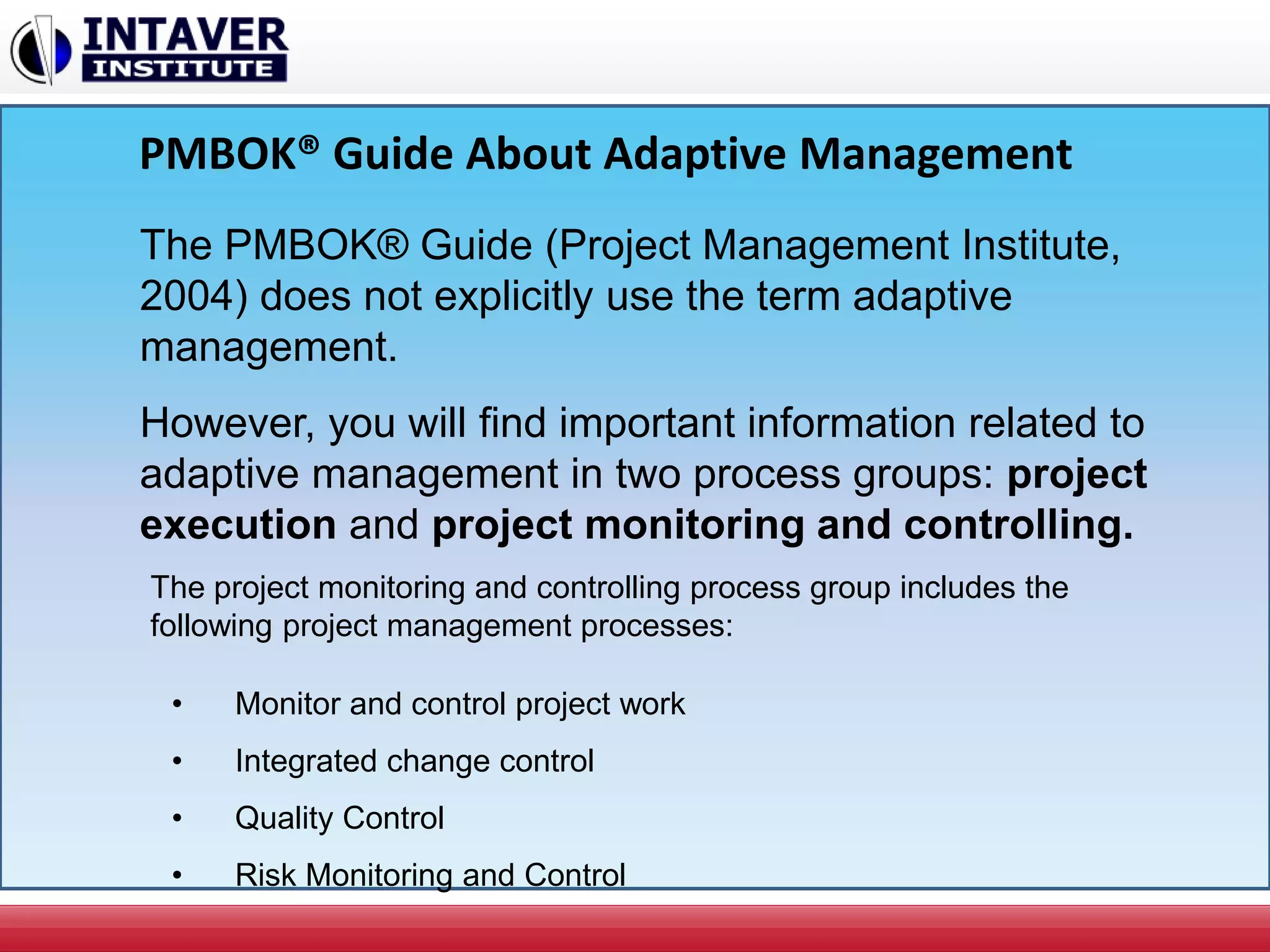

PMBOK® Guide About Adaptive Management
The PMBOK® Guide (Project Management Institute,
2004) does not explicitly use the term adaptive
management.
However, you will find important information related to
adaptive management in two process groups: project
execution and project monitoring and controlling.
• Monitor and control project work
• Integrated change control
• Quality Control
• Risk Monitoring and Control
The project monitoring and controlling process group includes the
following project management processes:
Most Living Organisms Are Able to Adapt
Except one
creature
This creature is
the project
manager
Why? - Human psychology

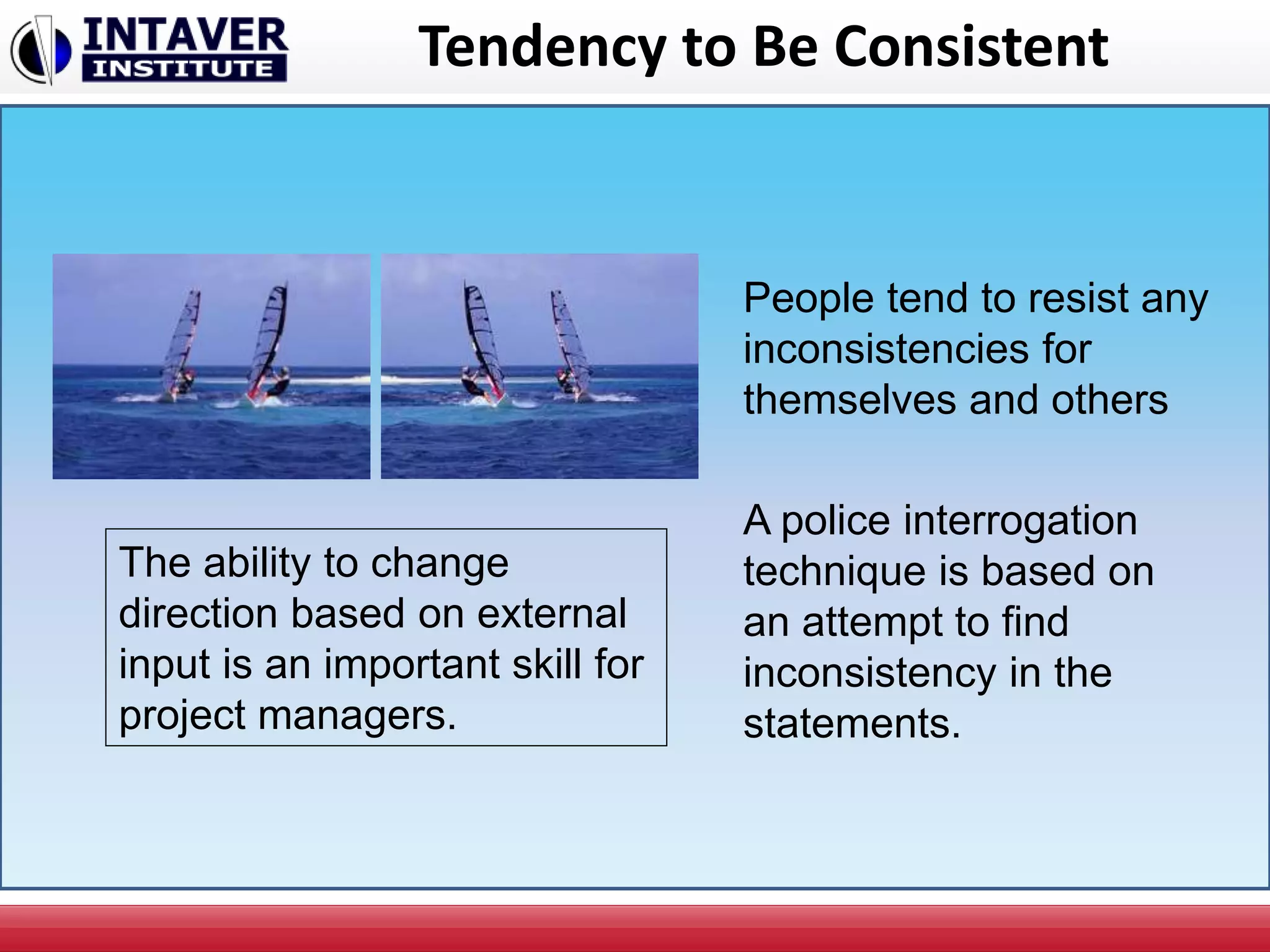

Tendency to Be Consistent
People tend to resist any
inconsistencies for
themselves and others
The ability to change
direction based on external
input is an important skill for
project managers.
A police interrogation
technique is based on
an attempt to find
inconsistency in the
statements.

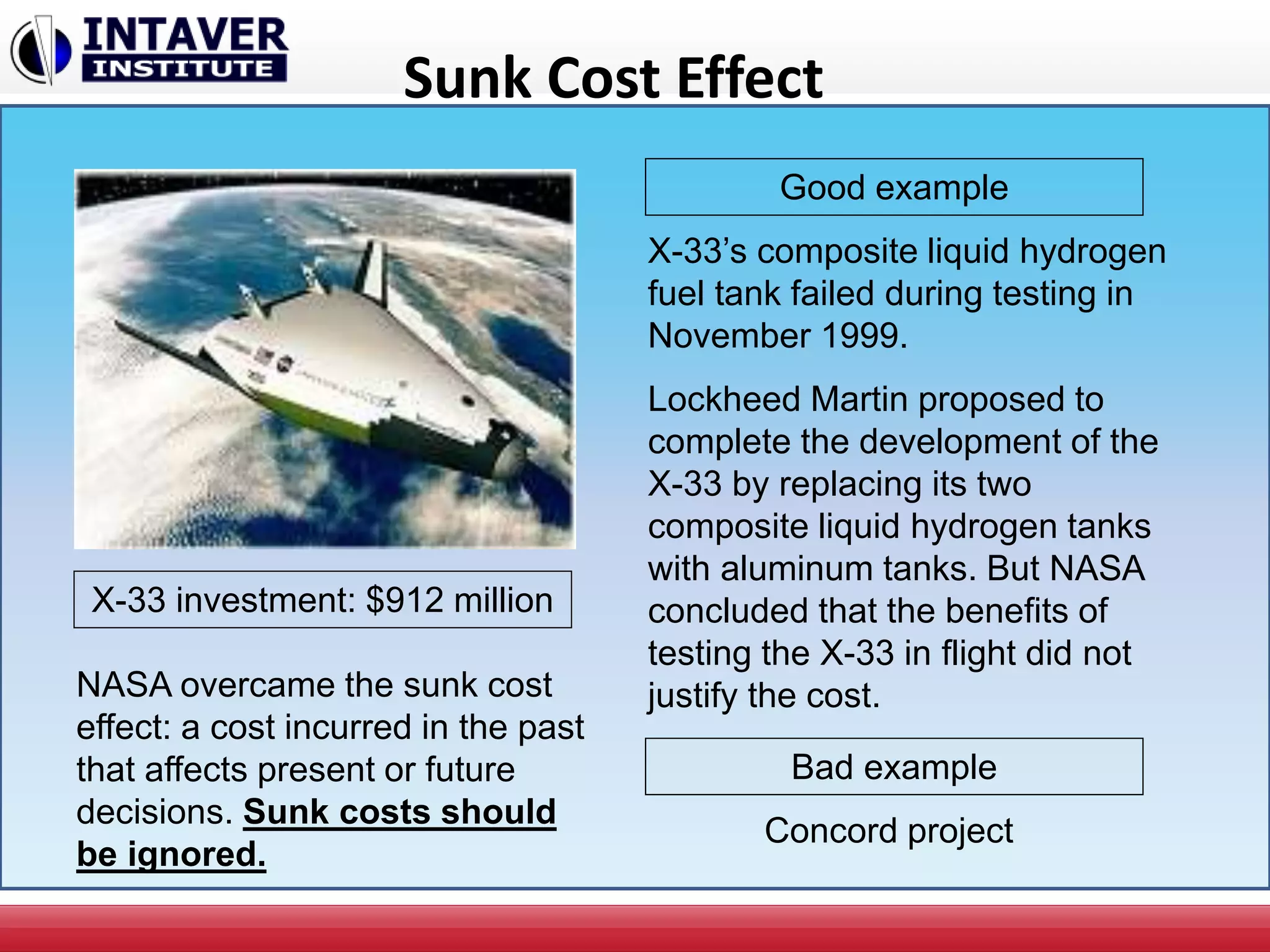

Sunk Cost Effect
X-33’s composite liquid hydrogen
fuel tank failed during testing in
November 1999.
Lockheed Martin proposed to
complete the development of the
X-33 by replacing its two
composite liquid hydrogen tanks
with aluminum tanks. But NASA
concluded that the benefits of
testing the X-33 in flight did not
justify the cost.
X-33 investment: $912 million
NASA overcame the sunk cost
effect: a cost incurred in the past
that affects present or future
decisions. Sunk costs should
be ignored.
Good example
Bad example
Concord project

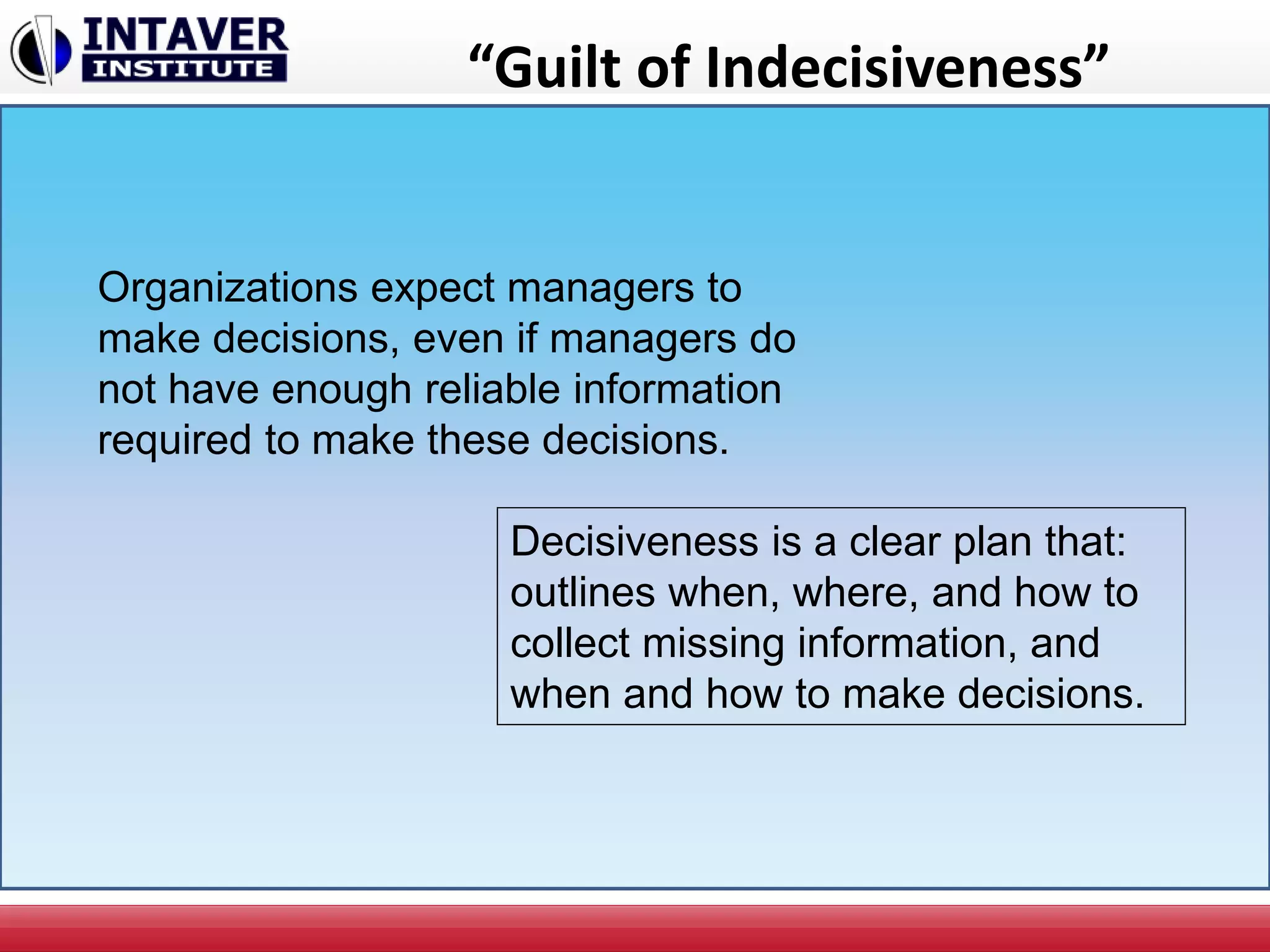

“Guilt of Indecisiveness”
Organizations expect managers to
make decisions, even if managers do
not have enough reliable information
required to make these decisions.
Decisiveness is a clear plan that:
outlines when, where, and how to
collect missing information, and
when and how to make decisions.

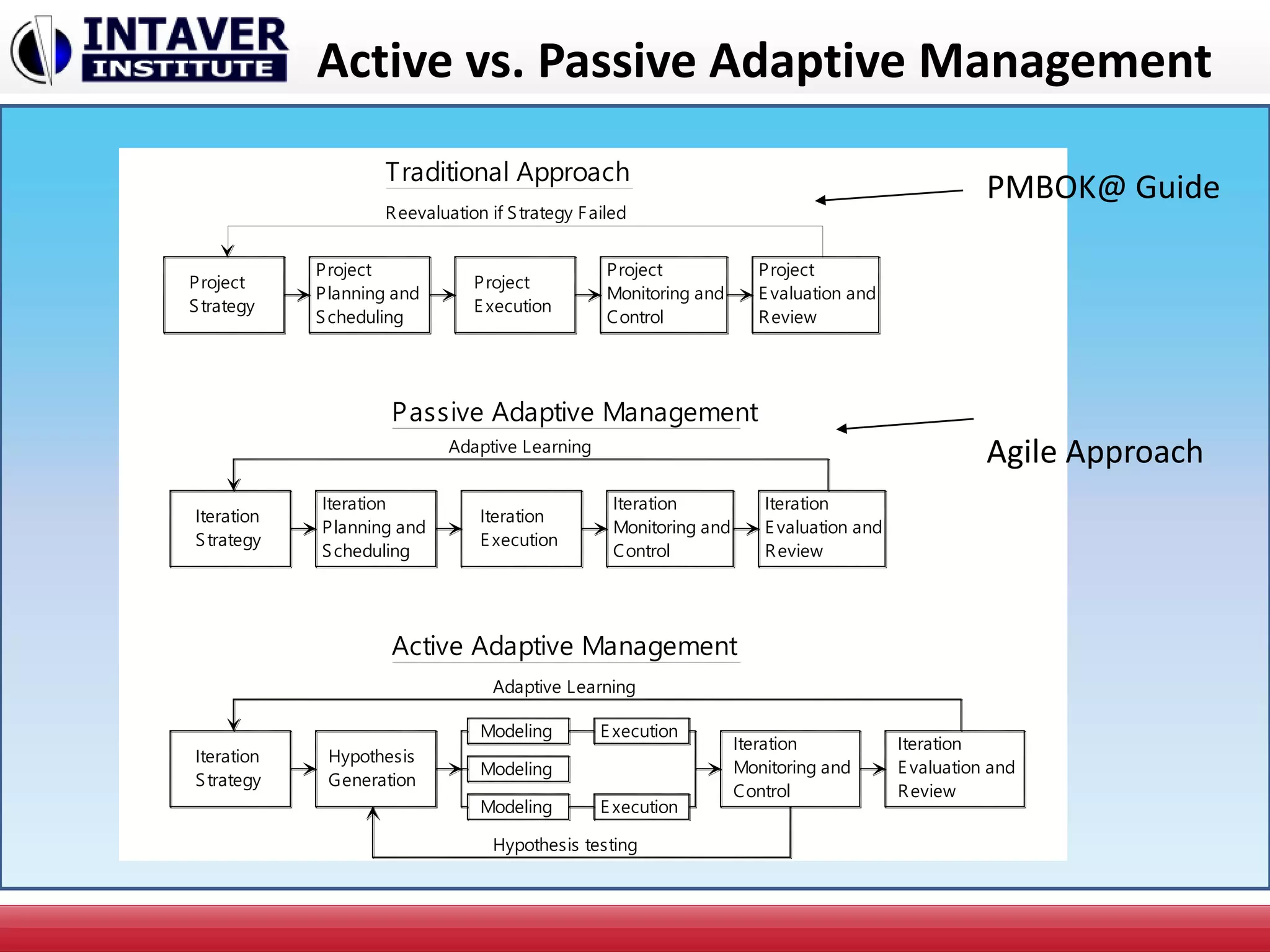

Active vs. Passive Adaptive Management
Project
Strategy
Project
E xecution
Project
Monitoring and
Control
Project
E valuation and
Review
Project
Planning and
Scheduling
Reevaluation if Strategy Failed
Adaptive Learning
Iteration
Planning and
Scheduling
Iteration
Strategy E xecution
Iteration
Review
E valuation and
Iteration
Monitoring and
Control
Iteration
Strategy
Iteration Hypothesis
Generation
Modeling
Modeling
Modeling
E xecution
E xecution
Iteration
Monitoring and
Control
Iteration
E valuation and
Review
Adaptive Learning
Hypothesis testing
Traditional Approach
Passive Adaptive Management
Active Adaptive Management
PMBOK@ Guide
Agile Approach

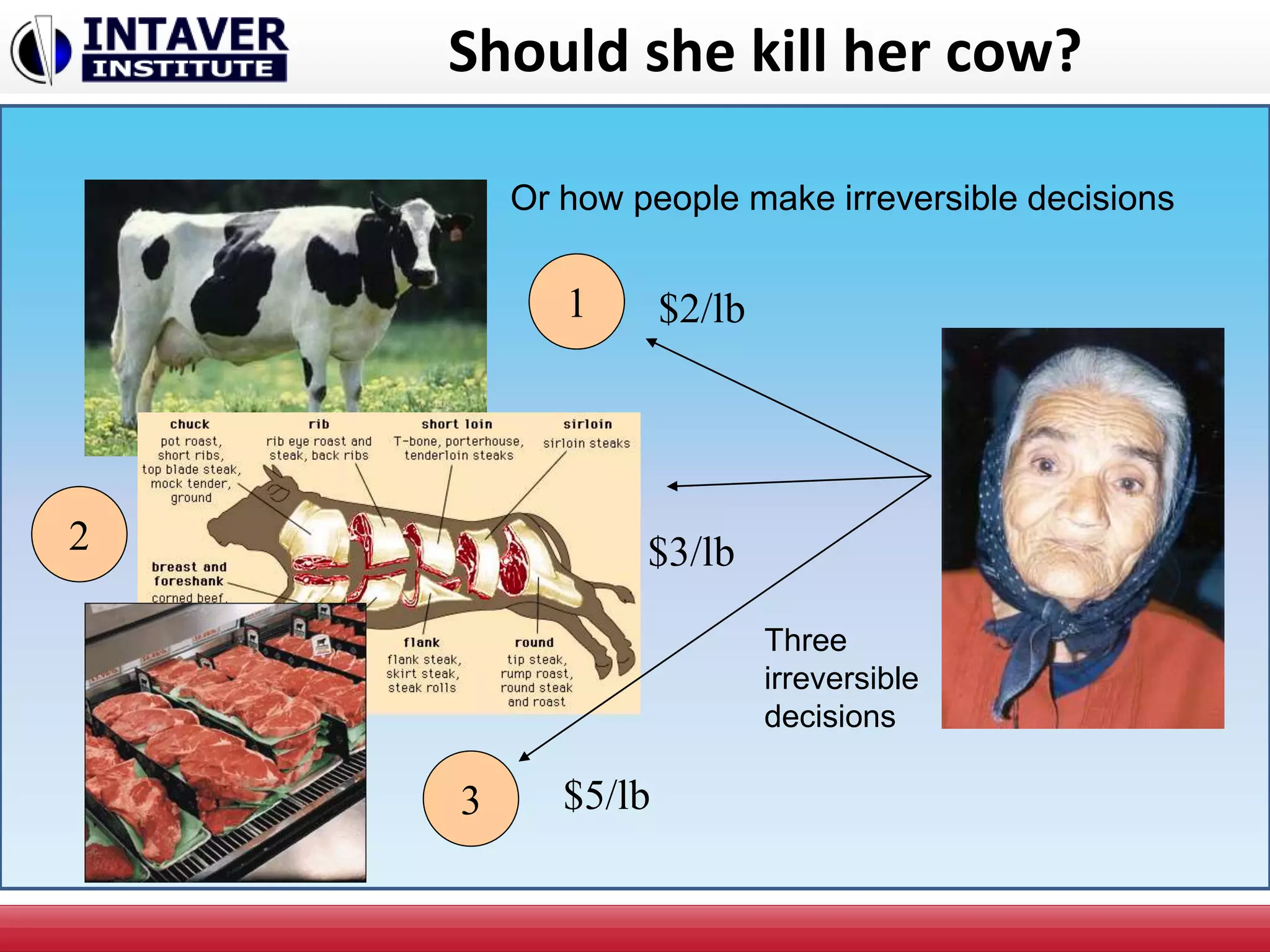

Should she kill her cow?
1
2
3
$2/lb
$3/lb
$5/lb
Or how people make irreversible decisions
Three
irreversible
decisions

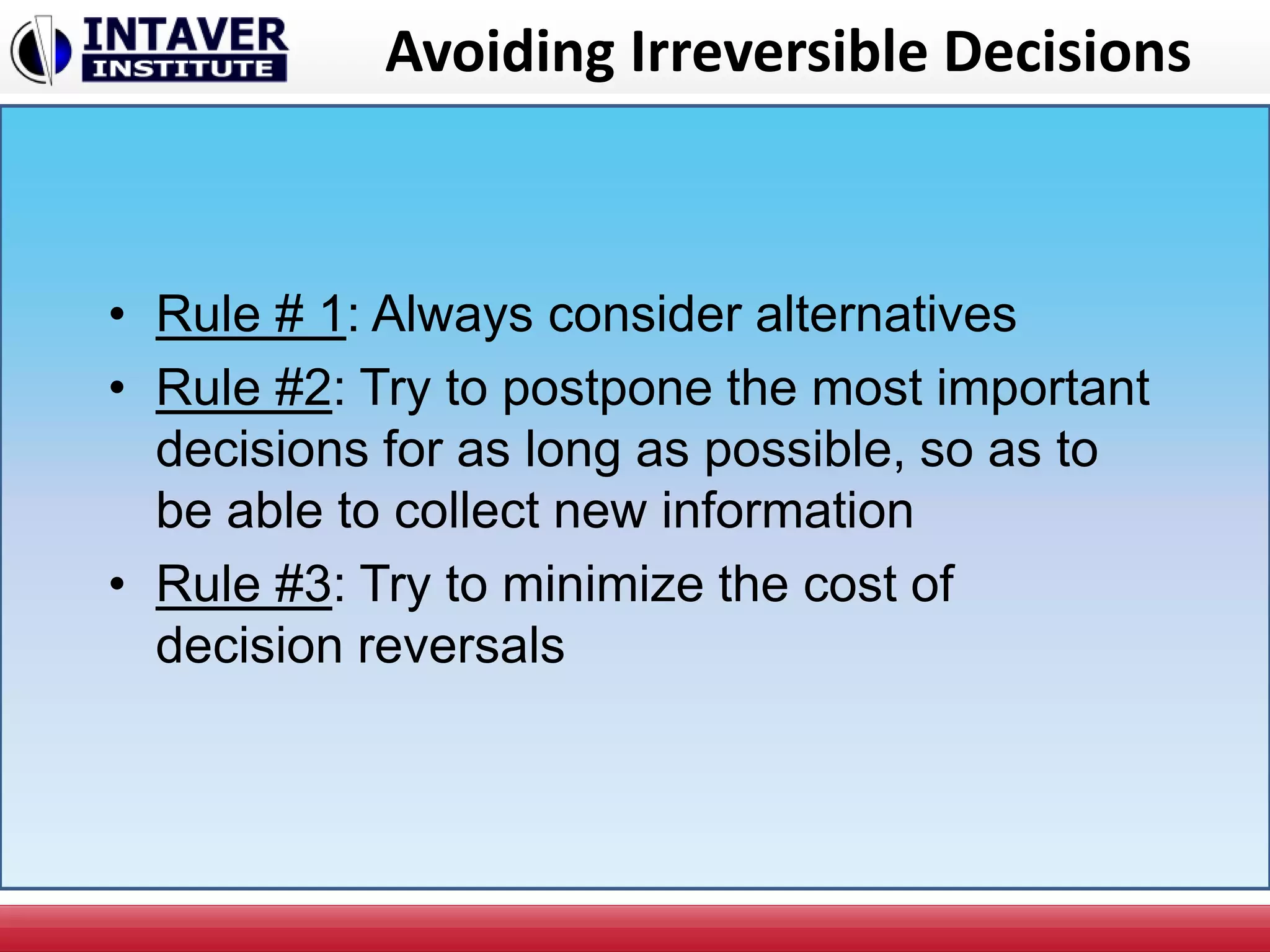

Avoiding Irreversible Decisions
• Rule # 1: Always consider alternatives
• Rule #2: Try to postpone the most important
decisions for as long as possible, so as to
be able to collect new information
• Rule #3: Try to minimize the cost of
decision reversals

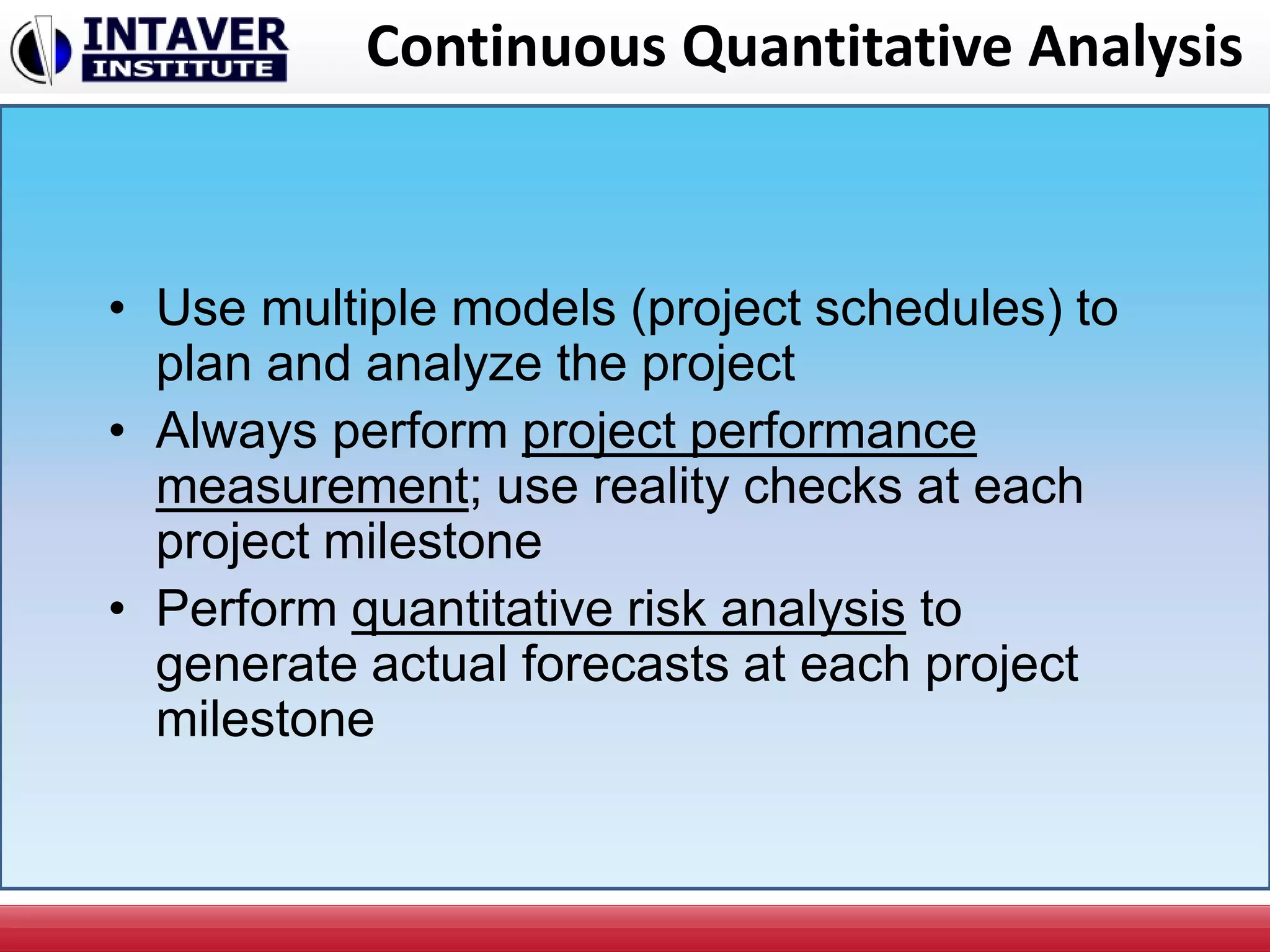

Continuous Quantitative Analysis
• Use multiple models (project schedules) to
plan and analyze the project
• Always perform project performance
measurement; use reality checks at each
project milestone
• Perform quantitative risk analysis to
generate actual forecasts at each project
milestone
Role of Project Metrics

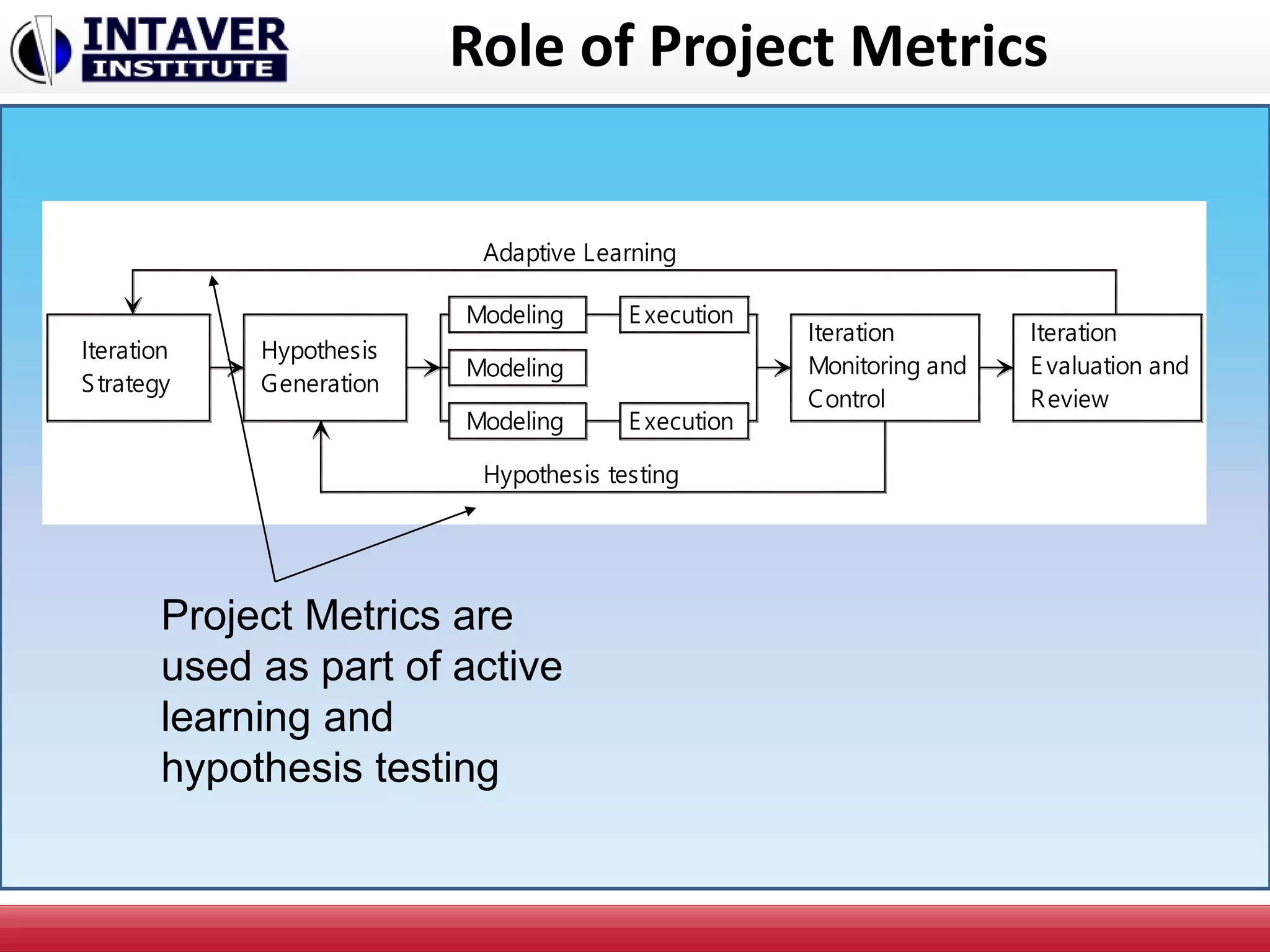

Hypothesis testing
Adaptive Learning
Review
Evaluation and
Iteration
Control
Monitoring and
Iteration
Execution
Execution
Modeling
Modeling
Modeling
Generation
HypothesisIteration
Strategy
Project Metrics are
used as part of active
learning and
hypothesis testing

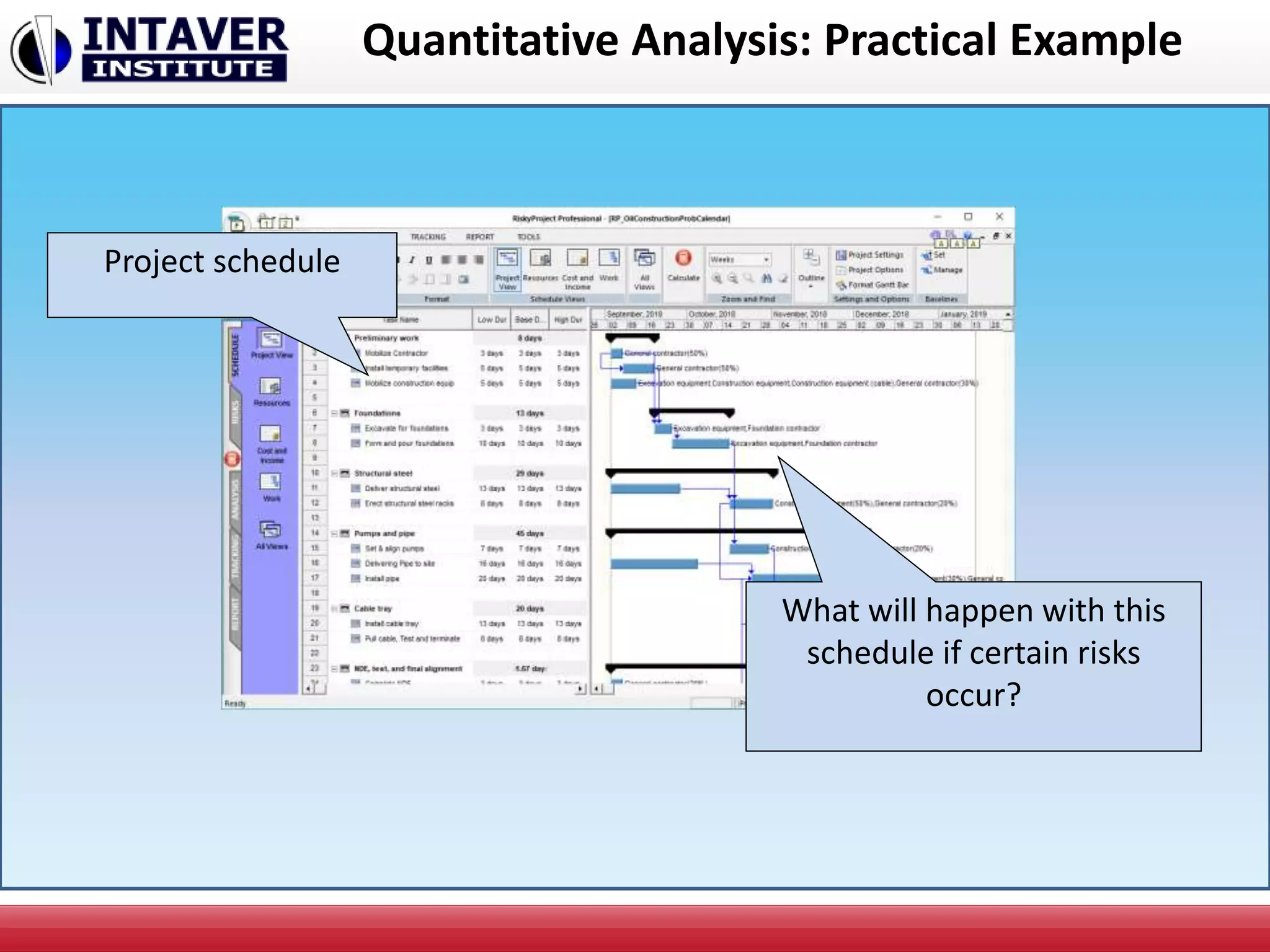

Quantitative Analysis: Practical Example
Project schedule
What will happen with this
schedule if certain risks
occur?

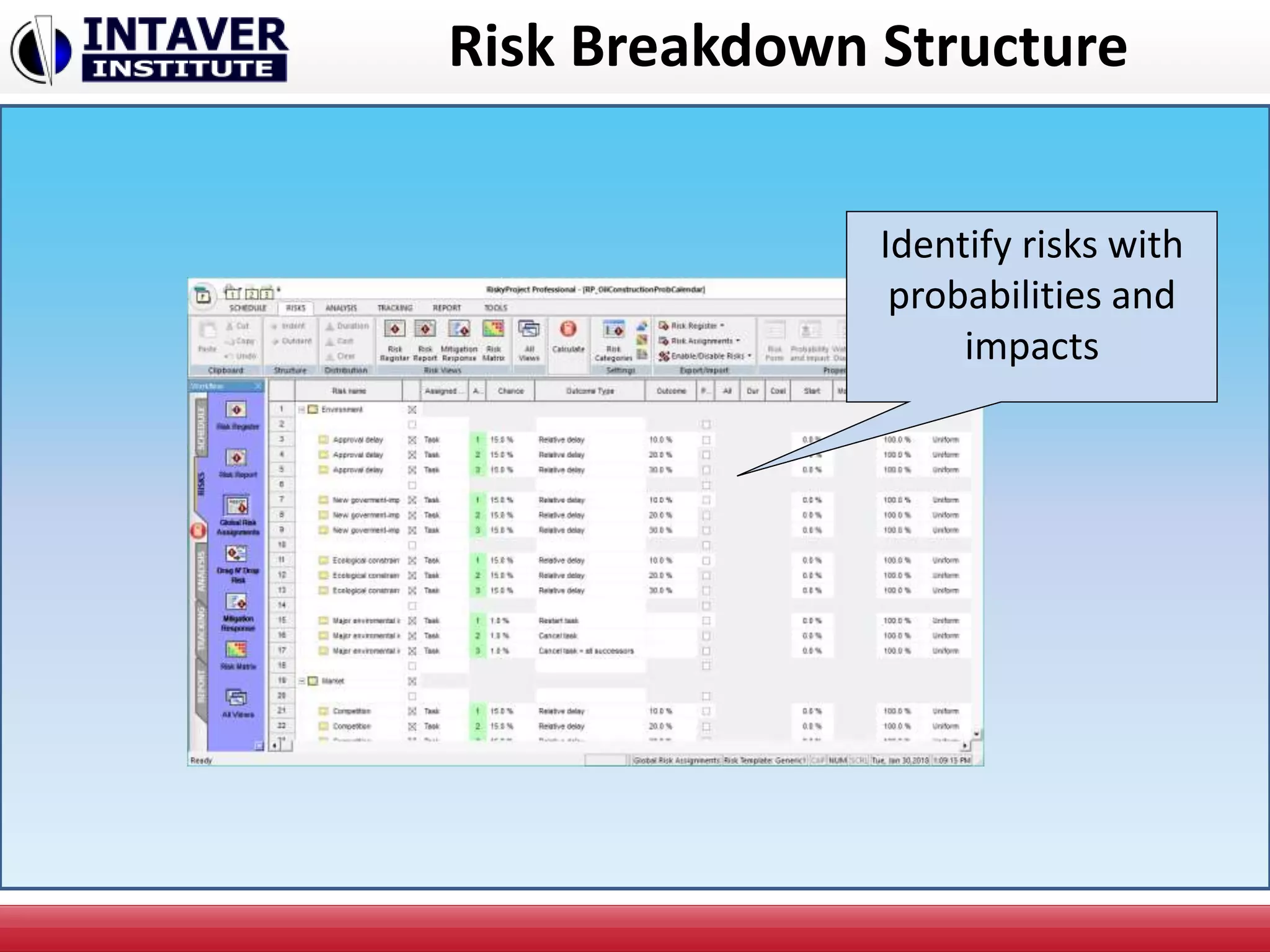

Risk Breakdown Structure
Identify risks with
probabilities and
impacts

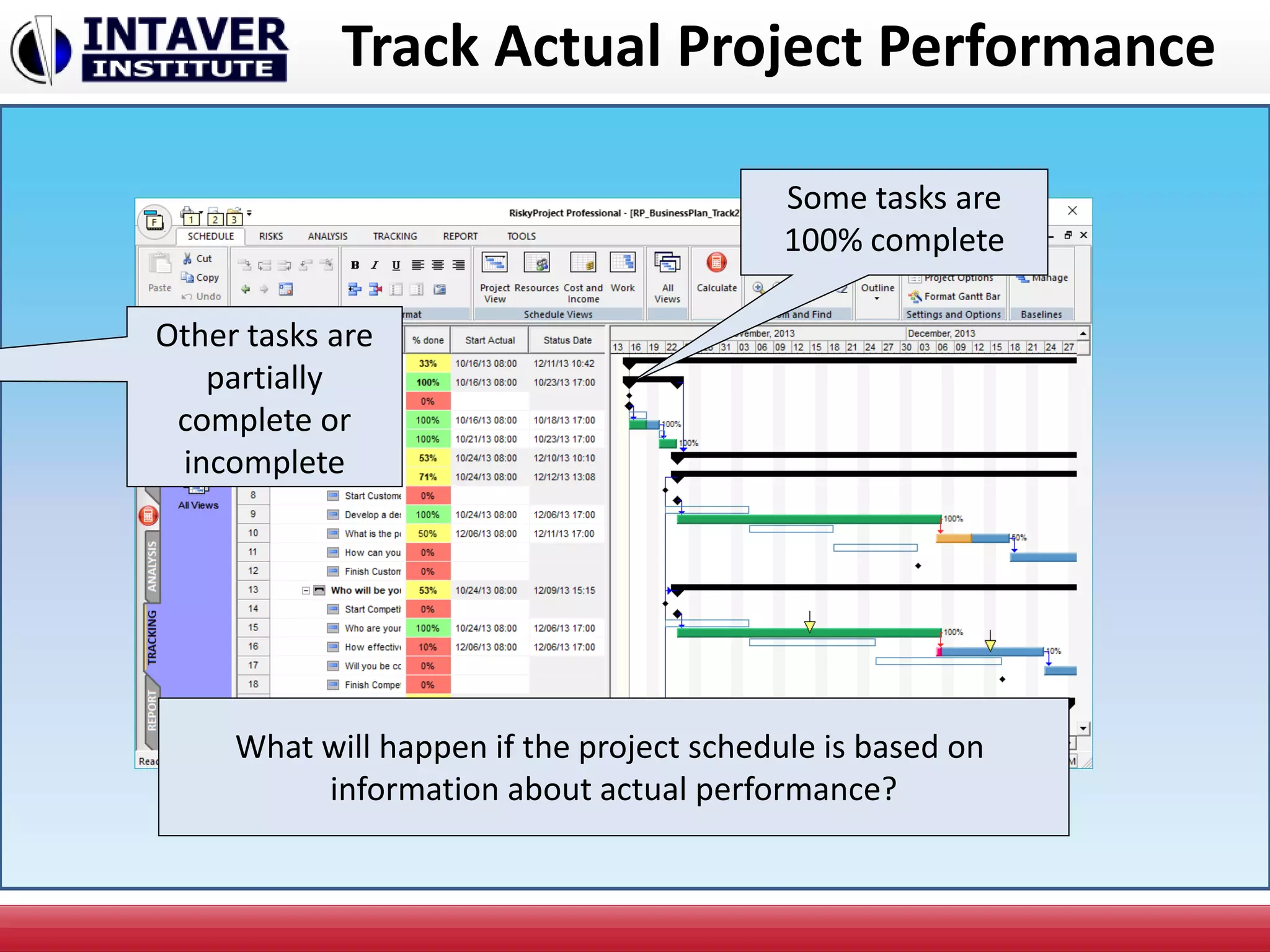

Track Actual Project Performance
Some tasks are
100% complete
Other tasks are
partially
complete or
incomplete
What will happen if the project schedule is based on
information about actual performance?

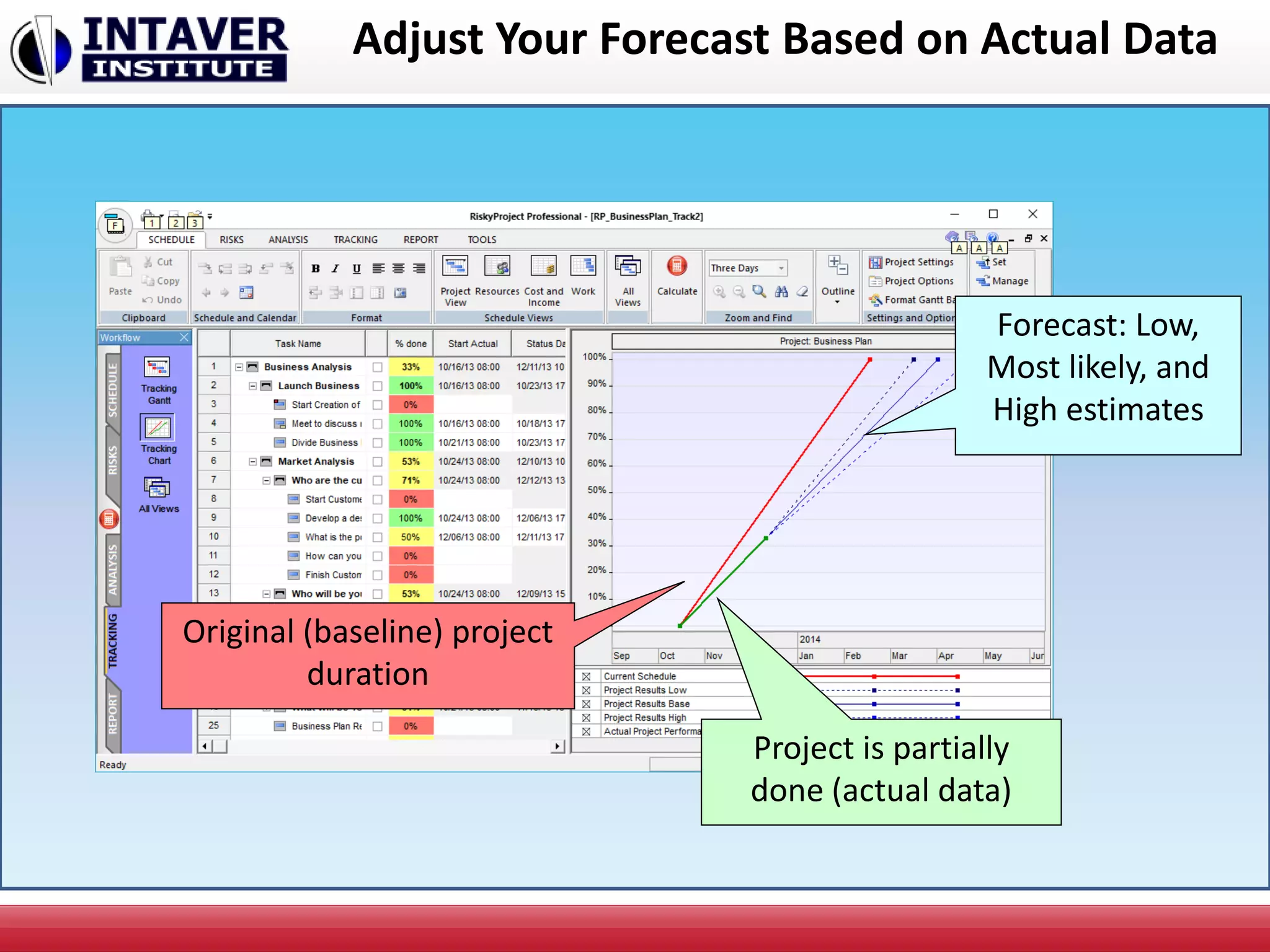

Adjust Your Forecast Based on Actual Data
Original (baseline) project
duration
Project is partially
done (actual data)
Forecast: Low,
Most likely, and
High estimates

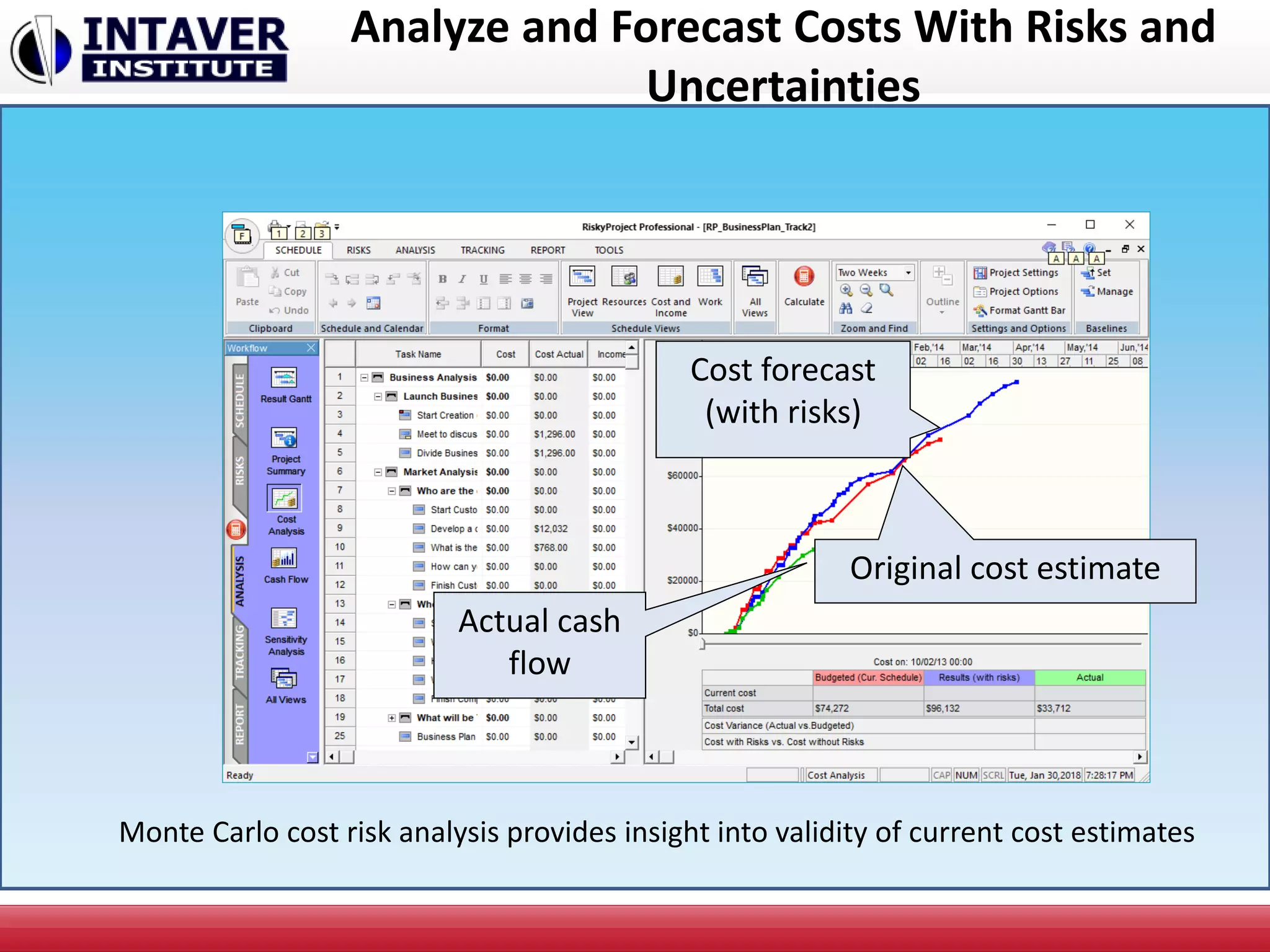

Analyze and Forecast Costs With Risks and
Uncertainties
Cost forecast
(with risks)
Original cost estimate
Actual cash
flow
Monte Carlo cost risk analysis provides insight into validity of current cost estimates

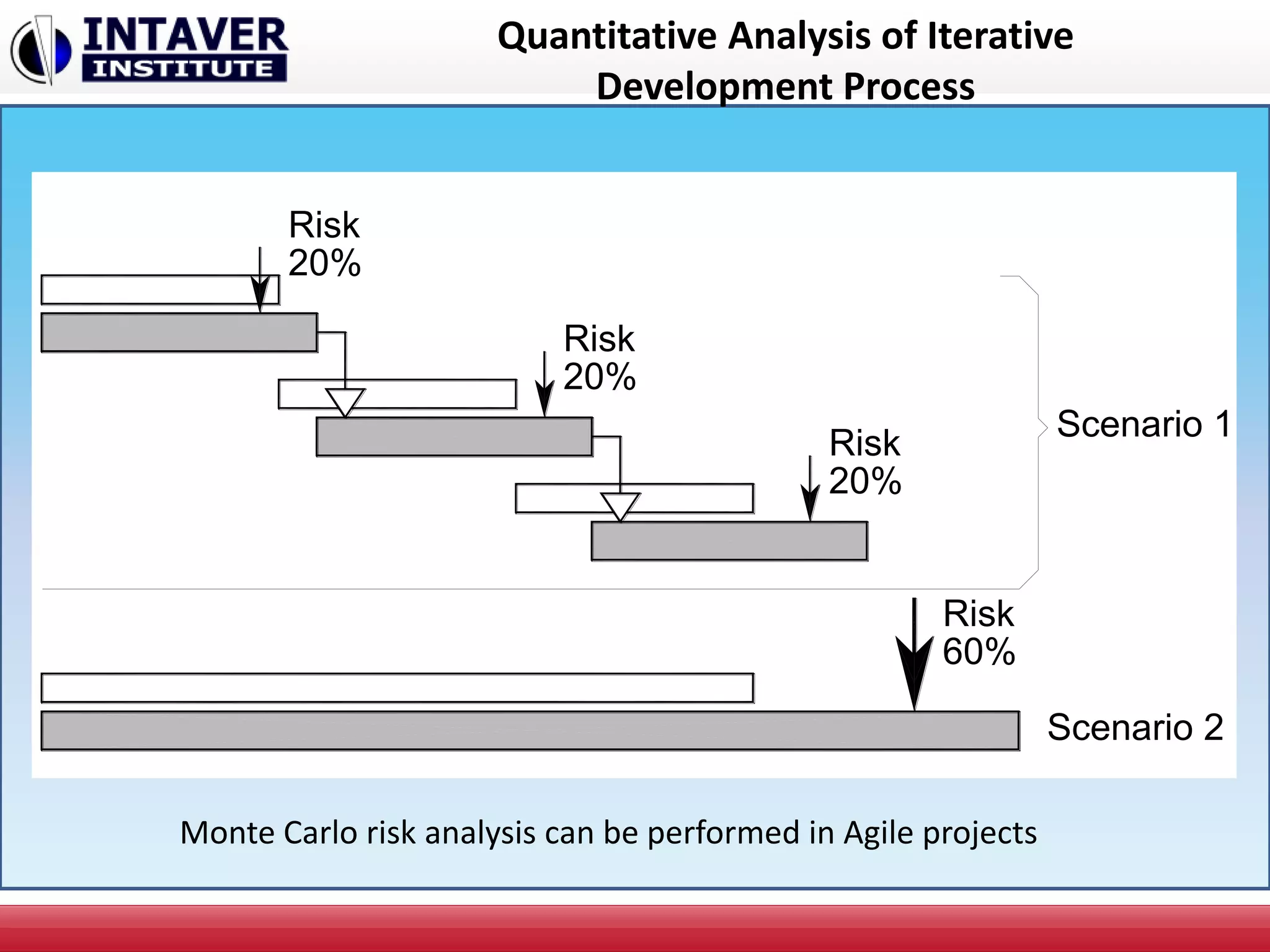

Quantitative Analysis of Iterative
Development Process
Risk
20%
Risk
20%
Risk
20%
Risk
60%
Scenario 1
Scenario 2
Monte Carlo risk analysis can be performed in Agile projects

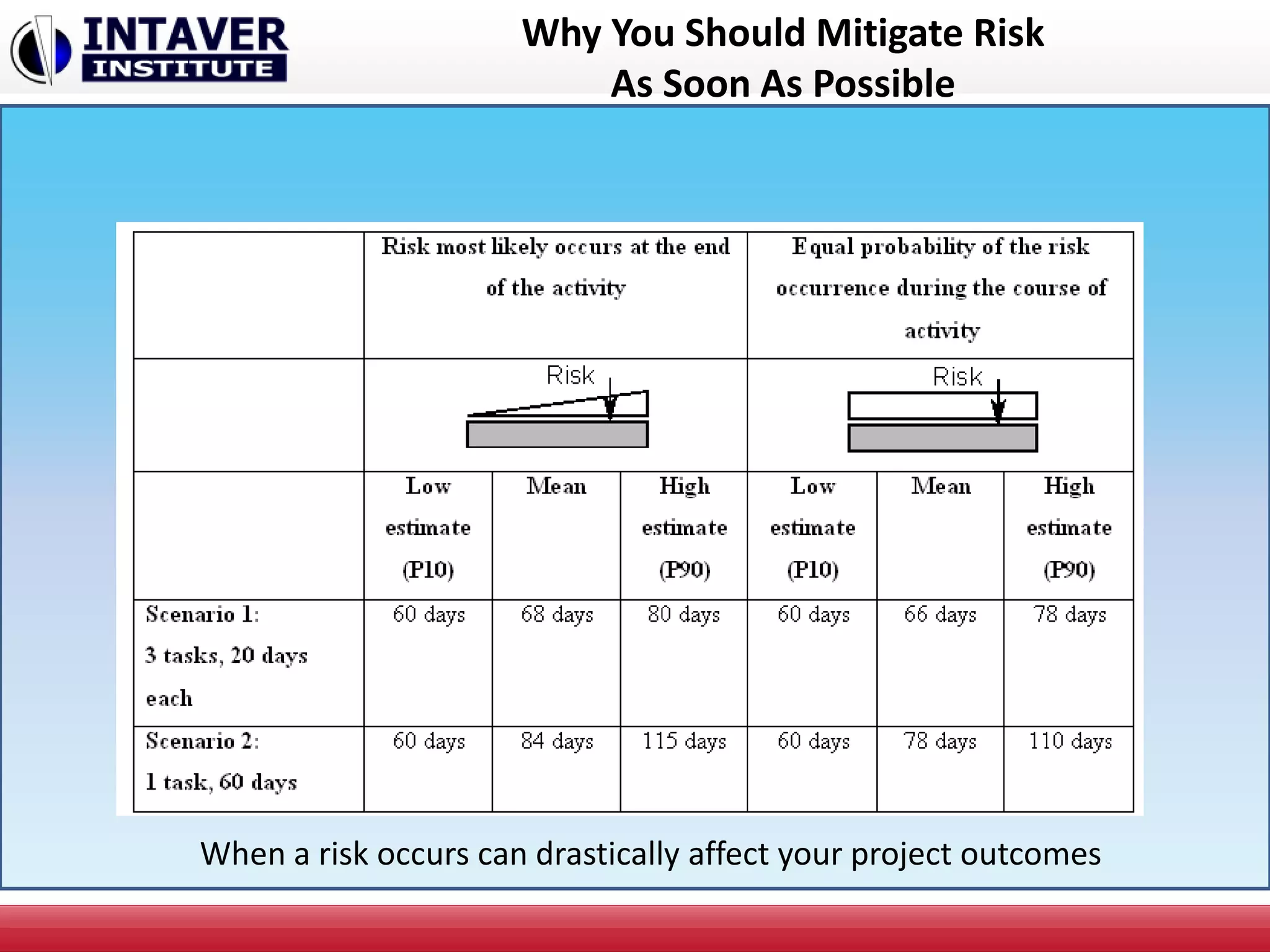

Why You Should Mitigate Risk
As Soon As Possible
When a risk occurs can drastically affect your project outcomes

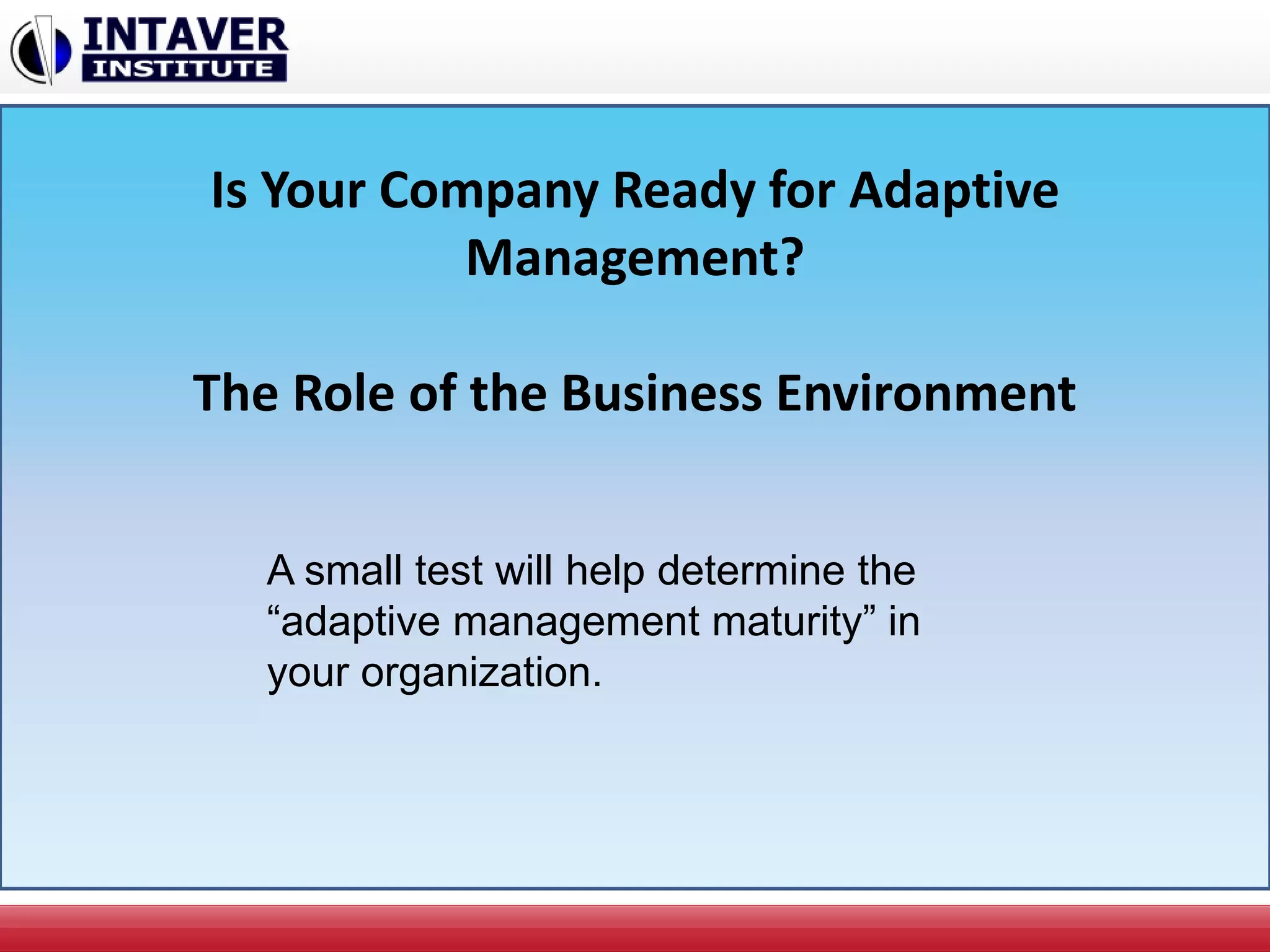

Is Your Company Ready for Adaptive
Management?
The Role of the Business Environment
A small test will help determine the
“adaptive management maturity” in
your organization.

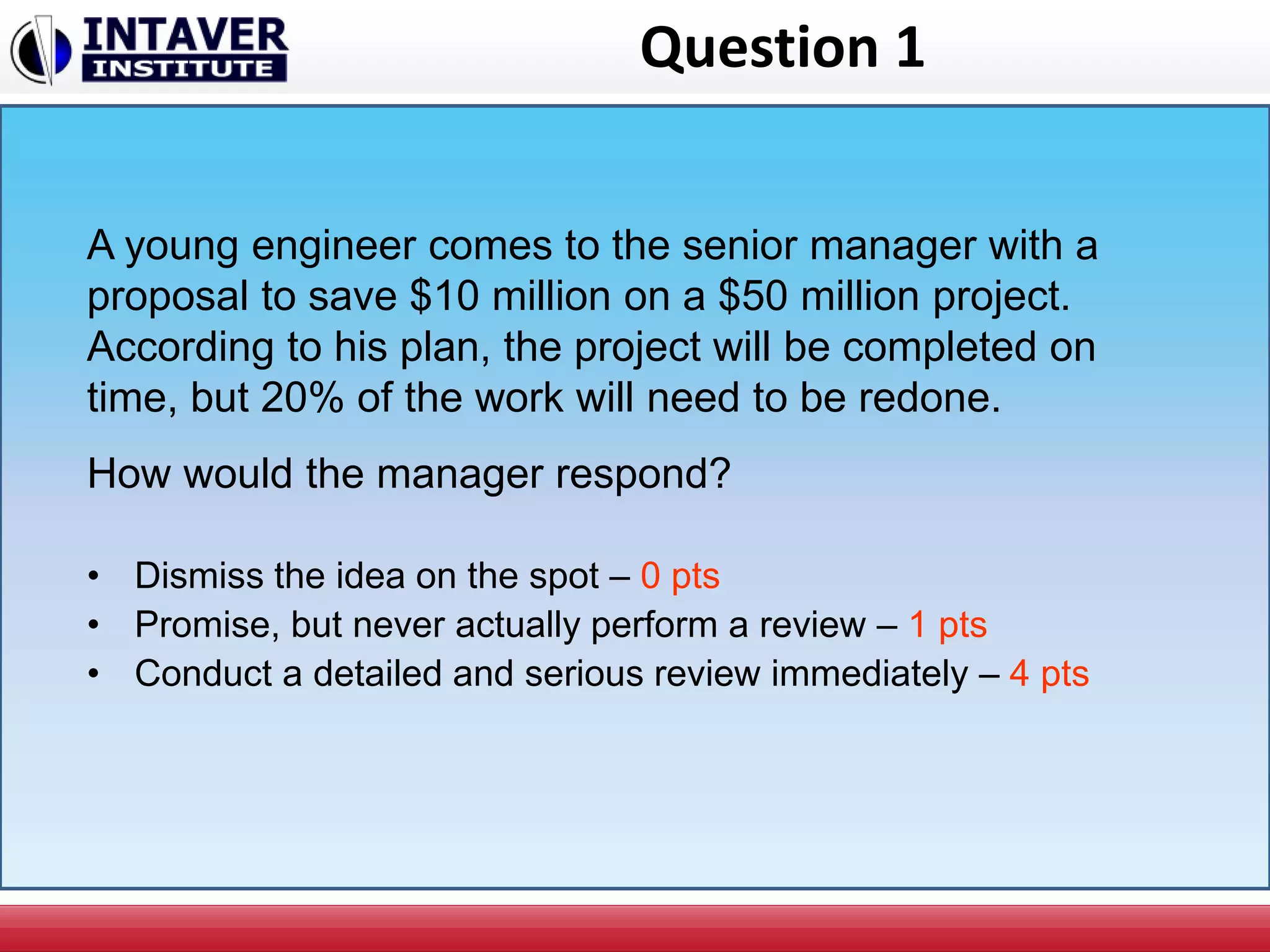

Question 1
• Dismiss the idea on the spot – 0 pts
• Promise, but never actually perform a review – 1 pts
• Conduct a detailed and serious review immediately – 4 pts
A young engineer comes to the senior manager with a
proposal to save $10 million on a $50 million project.
According to his plan, the project will be completed on
time, but 20% of the work will need to be redone.
How would the manager respond?

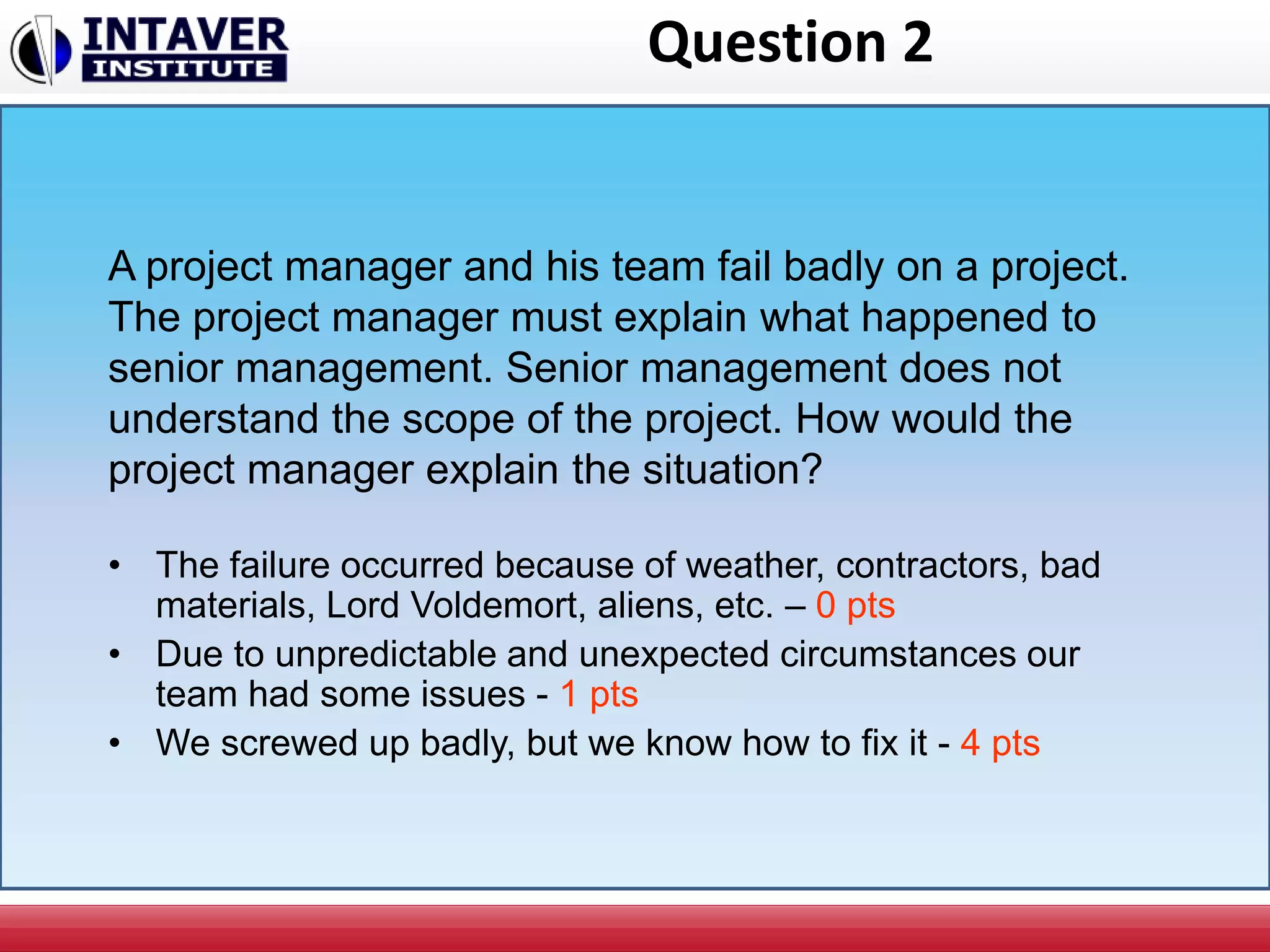

Question 2
• The failure occurred because of weather, contractors, bad
materials, Lord Voldemort, aliens, etc. – 0 pts
• Due to unpredictable and unexpected circumstances our
team had some issues - 1 pts
• We screwed up badly, but we know how to fix it - 4 pts
A project manager and his team fail badly on a project.
The project manager must explain what happened to
senior management. Senior management does not
understand the scope of the project. How would the
project manager explain the situation?

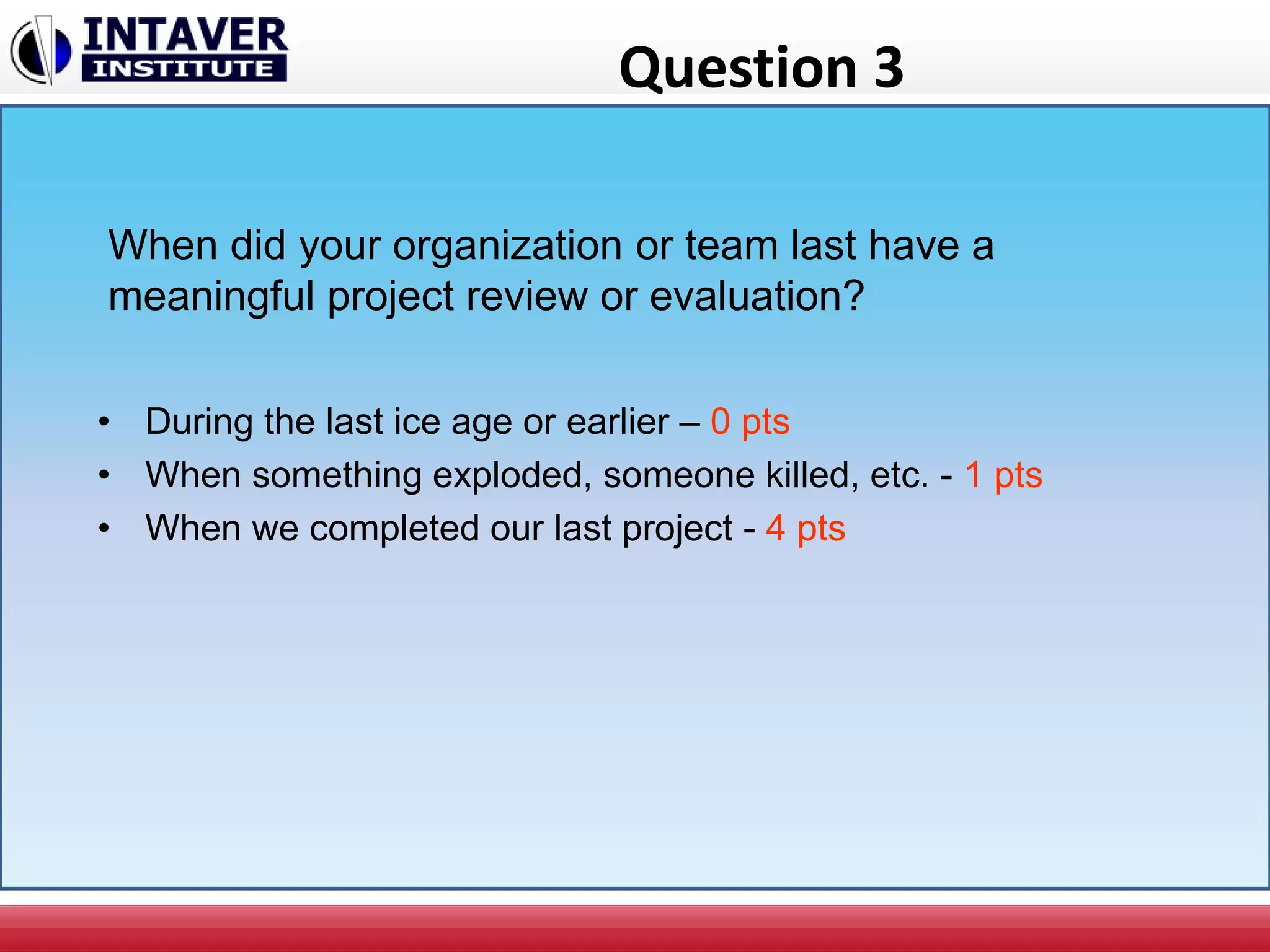

Question 3
When did your organization or team last have a
meaningful project review or evaluation?
• During the last ice age or earlier – 0 pts
• When something exploded, someone killed, etc. - 1 pts
• When we completed our last project - 4 pts

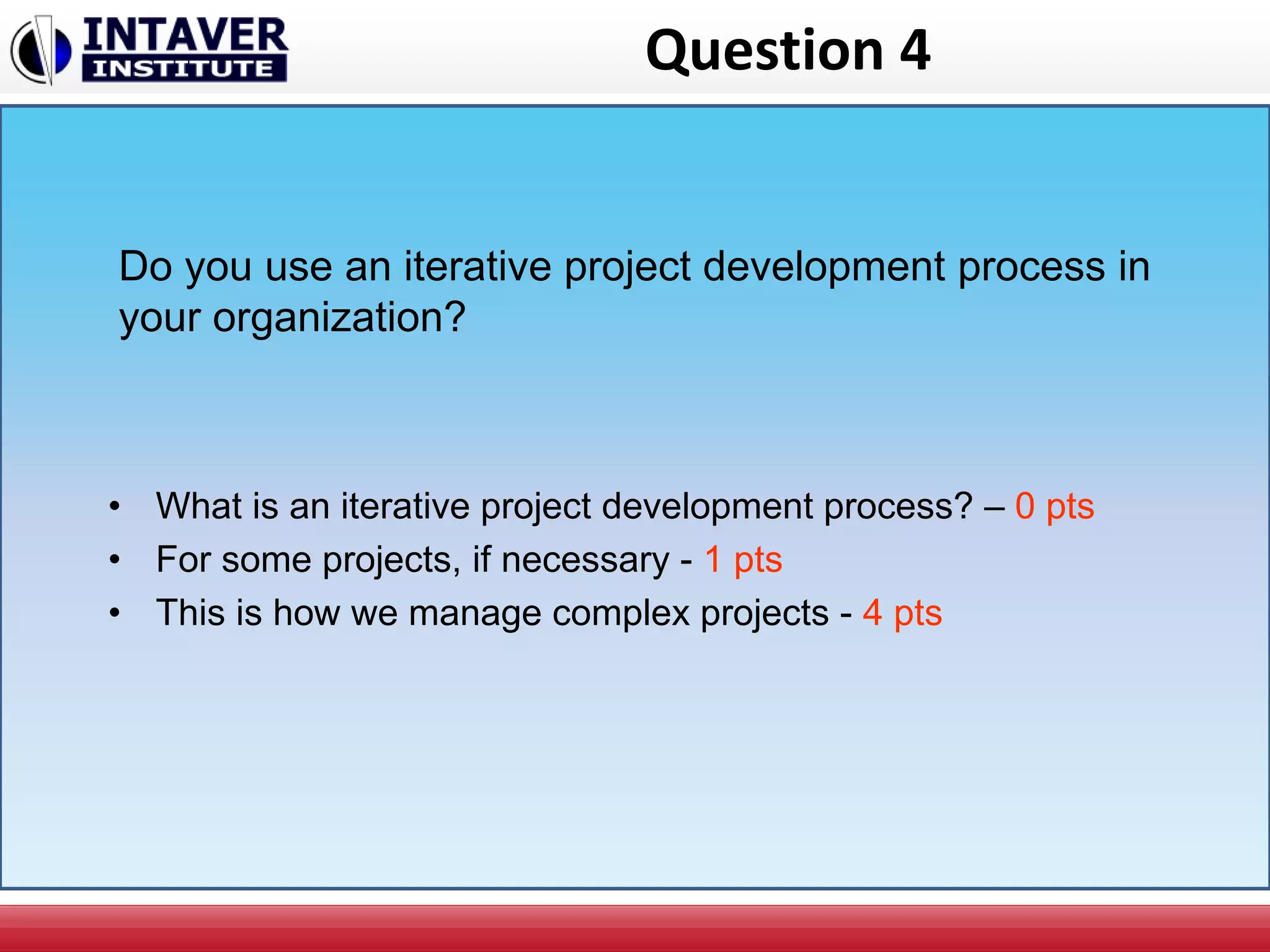

Question 4
Do you use an iterative project development process in
your organization?
• What is an iterative project development process? – 0 pts
• For some projects, if necessary - 1 pts
• This is how we manage complex projects - 4 pts

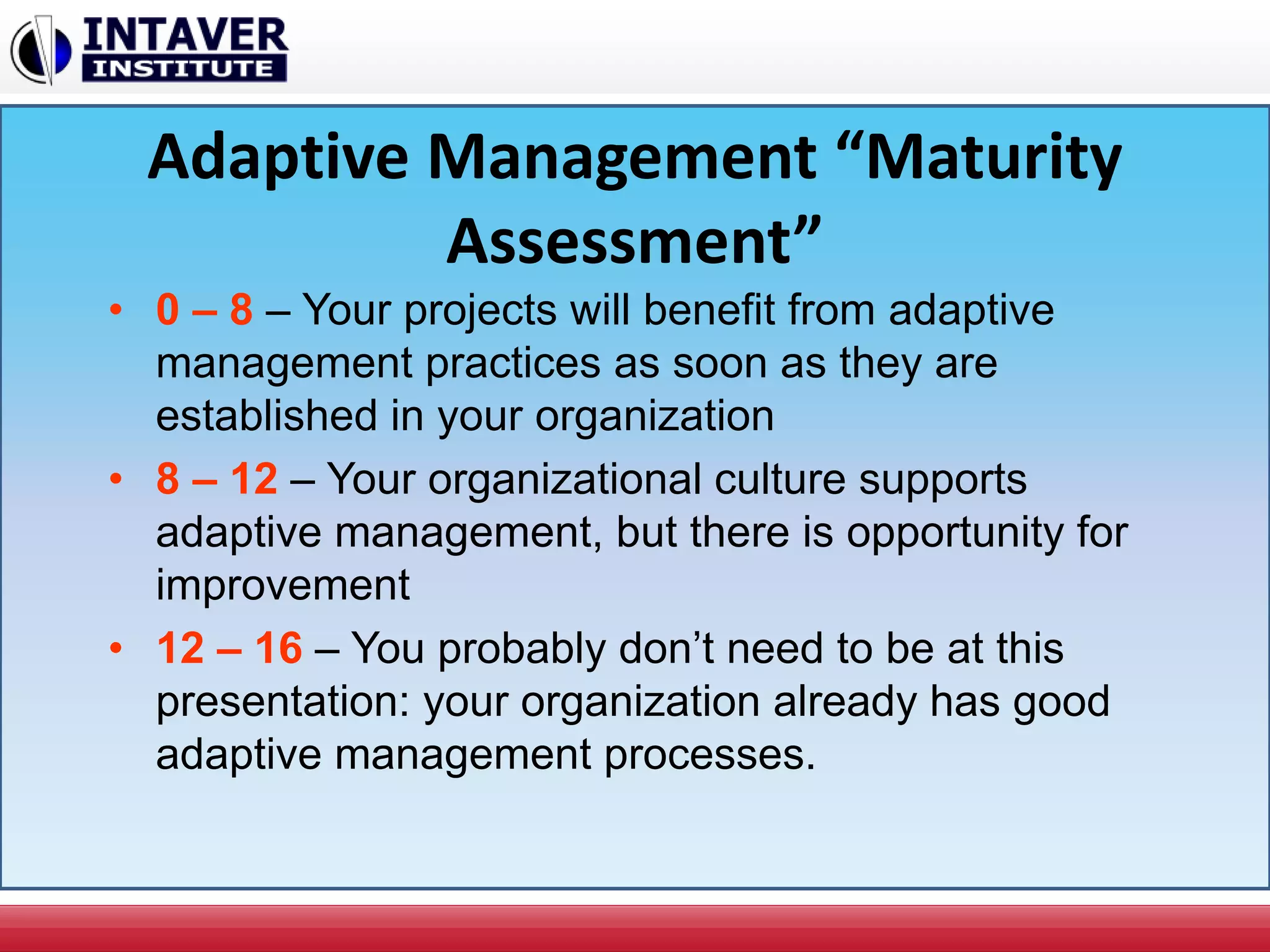

Adaptive Management “Maturity
Assessment”
• 0 – 8 – Your projects will benefit from adaptive
management practices as soon as they are
established in your organization
• 8 – 12 – Your organizational culture supports
adaptive management, but there is opportunity for
improvement
• 12 – 16 – You probably don’t need to be at this
presentation: your organization already has good
adaptive management processes.

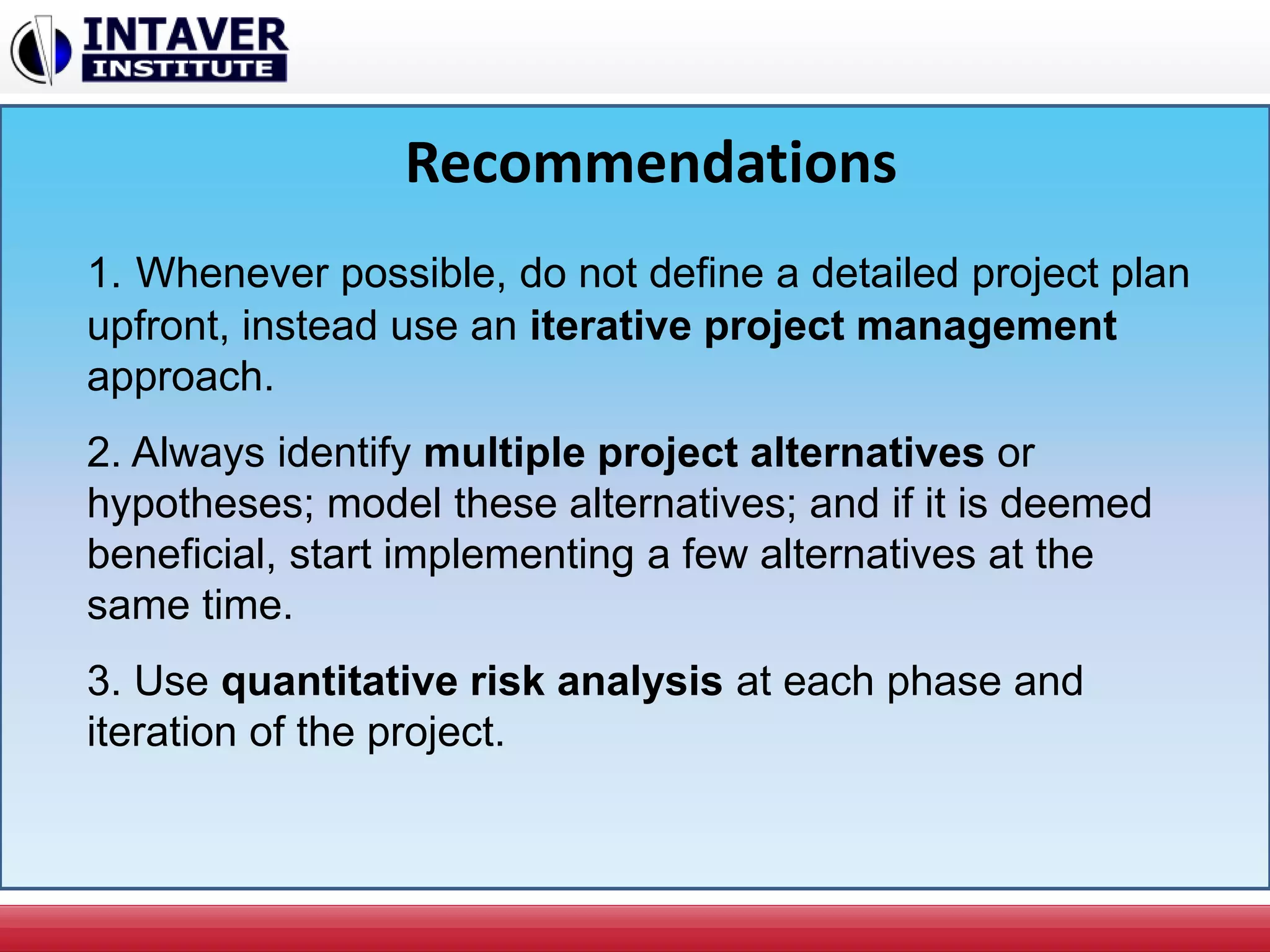

Recommendations
1. Whenever possible, do not define a detailed project plan
upfront, instead use an iterative project management
approach.
2. Always identify multiple project alternatives or
hypotheses; model these alternatives; and if it is deemed
beneficial, start implementing a few alternatives at the
same time.
3. Use quantitative risk analysis at each phase and
iteration of the project.

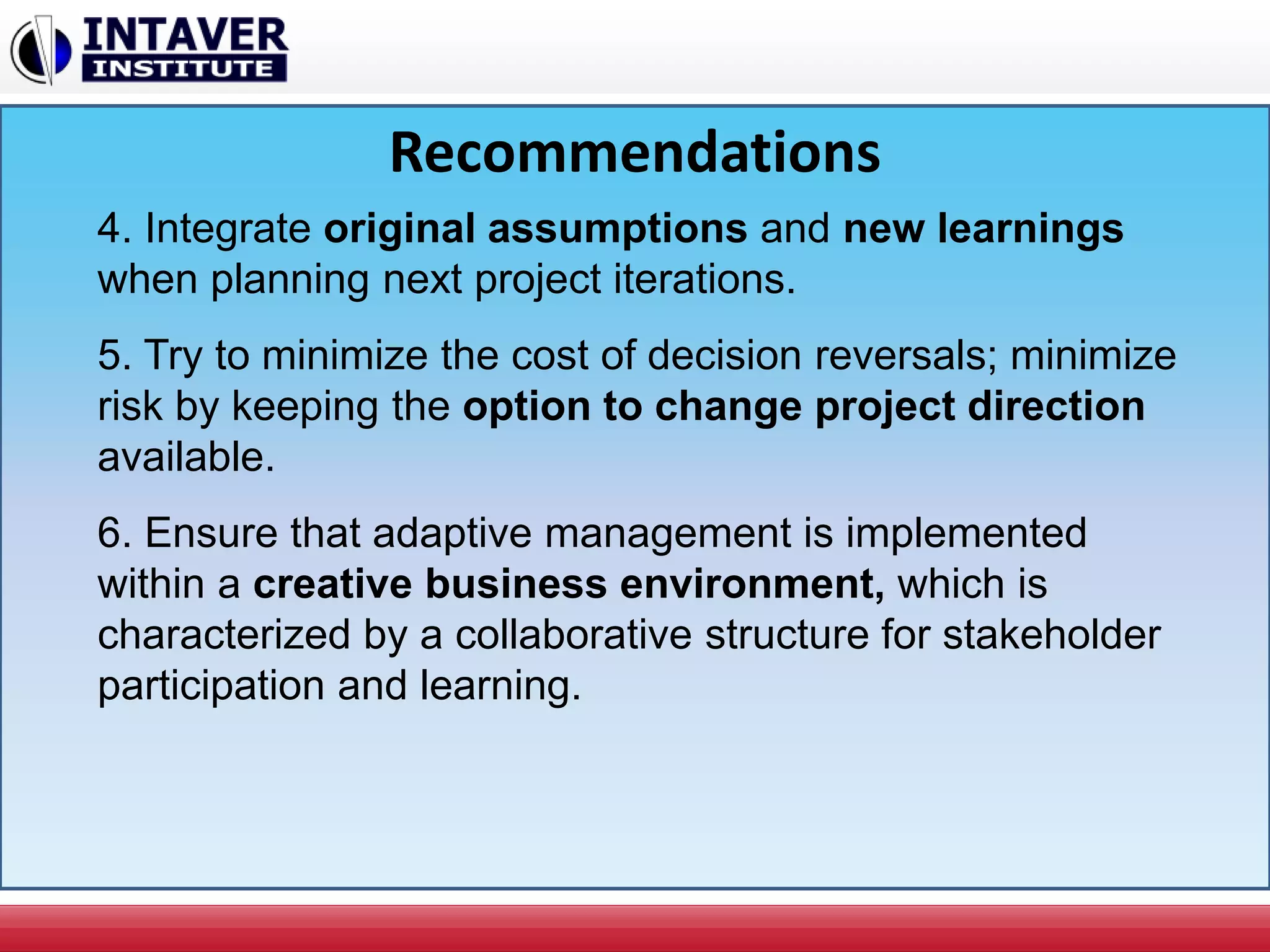

Recommendations
4. Integrate original assumptions and new learnings
when planning next project iterations.
5. Try to minimize the cost of decision reversals; minimize
risk by keeping the option to change project direction
available.
6. Ensure that adaptive management is implemented
within a creative business environment, which is
characterized by a collaborative structure for stakeholder
participation and learning.
Additional Resources
31
Project Think:
Why Good
Managers Make
Poor Project
Choices
Project Decisions:
The Art and Science
Introduction to
Project Risk
Management and
Decision Analysis
Project Risk
Analysis Made
Ridiculously Simple
Questions?

Project Management: Adaptive management

  • 1.
    Adaptive Management Intaver InstituteInc. 303, 6707, Elbow Drive S.W, Calgary, AB, Canada Tel: +1(403)692-2252 Fax: +1(403)459-4533 www.intaver.com
  • 2.
    Power of Adaptation WillPolar Bears Be Extinct Because of Global Warming? Hopefully not, as they are capable of adapting to changing conditions
  • 3.
    Adaptive Management Adaptive managementis a structured and systematic process for continually improving decisions, management policies, and practices by learning from the outcomes of previous decisions. Proposed by ecologists C.S. Holling and Carl J. Walters as a framework for managing ecological problems Adaptive management of fish stocks
  • 4.
    Agile Project Management Weare uncovering better ways of developing software by doing it and helping others do it. Through this work we have come to value: Individuals and interactions over processes and tools Working software over comprehensive documentation Customer collaboration over contract negotiation Responding to change over following a plan From the Agile Manifesto:
  • 5.
    Main Principles ofAdaptive Management • Iterative decision- making: make choices based on learning from the outcomes of previous decisions • Strategic flexibility: avoid irreversible decisions • Continuous quantitative analysis: multi-model analysis and hypothesis testing • Measurement of actual performance Organizational Principles Quantitative Methods
  • 6.
    PMBOK® Guide AboutAdaptive Management The PMBOK® Guide (Project Management Institute, 2004) does not explicitly use the term adaptive management. However, you will find important information related to adaptive management in two process groups: project execution and project monitoring and controlling. • Monitor and control project work • Integrated change control • Quality Control • Risk Monitoring and Control The project monitoring and controlling process group includes the following project management processes:
  • 7.
    Most Living OrganismsAre Able to Adapt Except one creature This creature is the project manager Why? - Human psychology
  • 8.
    Tendency to BeConsistent People tend to resist any inconsistencies for themselves and others The ability to change direction based on external input is an important skill for project managers. A police interrogation technique is based on an attempt to find inconsistency in the statements.
  • 9.
    Sunk Cost Effect X-33’scomposite liquid hydrogen fuel tank failed during testing in November 1999. Lockheed Martin proposed to complete the development of the X-33 by replacing its two composite liquid hydrogen tanks with aluminum tanks. But NASA concluded that the benefits of testing the X-33 in flight did not justify the cost. X-33 investment: $912 million NASA overcame the sunk cost effect: a cost incurred in the past that affects present or future decisions. Sunk costs should be ignored. Good example Bad example Concord project
  • 10.
    “Guilt of Indecisiveness” Organizationsexpect managers to make decisions, even if managers do not have enough reliable information required to make these decisions. Decisiveness is a clear plan that: outlines when, where, and how to collect missing information, and when and how to make decisions.
  • 11.
    Active vs. PassiveAdaptive Management Project Strategy Project E xecution Project Monitoring and Control Project E valuation and Review Project Planning and Scheduling Reevaluation if Strategy Failed Adaptive Learning Iteration Planning and Scheduling Iteration Strategy E xecution Iteration Review E valuation and Iteration Monitoring and Control Iteration Strategy Iteration Hypothesis Generation Modeling Modeling Modeling E xecution E xecution Iteration Monitoring and Control Iteration E valuation and Review Adaptive Learning Hypothesis testing Traditional Approach Passive Adaptive Management Active Adaptive Management PMBOK@ Guide Agile Approach
  • 12.
    Should she killher cow? 1 2 3 $2/lb $3/lb $5/lb Or how people make irreversible decisions Three irreversible decisions
  • 13.
    Avoiding Irreversible Decisions •Rule # 1: Always consider alternatives • Rule #2: Try to postpone the most important decisions for as long as possible, so as to be able to collect new information • Rule #3: Try to minimize the cost of decision reversals
  • 14.
    Continuous Quantitative Analysis •Use multiple models (project schedules) to plan and analyze the project • Always perform project performance measurement; use reality checks at each project milestone • Perform quantitative risk analysis to generate actual forecasts at each project milestone
  • 15.
    Role of ProjectMetrics Hypothesis testing Adaptive Learning Review Evaluation and Iteration Control Monitoring and Iteration Execution Execution Modeling Modeling Modeling Generation HypothesisIteration Strategy Project Metrics are used as part of active learning and hypothesis testing
  • 16.
    Quantitative Analysis: PracticalExample Project schedule What will happen with this schedule if certain risks occur?
  • 17.
    Risk Breakdown Structure Identifyrisks with probabilities and impacts
  • 18.
    Track Actual ProjectPerformance Some tasks are 100% complete Other tasks are partially complete or incomplete What will happen if the project schedule is based on information about actual performance?
  • 19.
    Adjust Your ForecastBased on Actual Data Original (baseline) project duration Project is partially done (actual data) Forecast: Low, Most likely, and High estimates
  • 20.
    Analyze and ForecastCosts With Risks and Uncertainties Cost forecast (with risks) Original cost estimate Actual cash flow Monte Carlo cost risk analysis provides insight into validity of current cost estimates
  • 21.
    Quantitative Analysis ofIterative Development Process Risk 20% Risk 20% Risk 20% Risk 60% Scenario 1 Scenario 2 Monte Carlo risk analysis can be performed in Agile projects
  • 22.
    Why You ShouldMitigate Risk As Soon As Possible When a risk occurs can drastically affect your project outcomes
  • 23.
    Is Your CompanyReady for Adaptive Management? The Role of the Business Environment A small test will help determine the “adaptive management maturity” in your organization.
  • 24.
    Question 1 • Dismissthe idea on the spot – 0 pts • Promise, but never actually perform a review – 1 pts • Conduct a detailed and serious review immediately – 4 pts A young engineer comes to the senior manager with a proposal to save $10 million on a $50 million project. According to his plan, the project will be completed on time, but 20% of the work will need to be redone. How would the manager respond?
  • 25.
    Question 2 • Thefailure occurred because of weather, contractors, bad materials, Lord Voldemort, aliens, etc. – 0 pts • Due to unpredictable and unexpected circumstances our team had some issues - 1 pts • We screwed up badly, but we know how to fix it - 4 pts A project manager and his team fail badly on a project. The project manager must explain what happened to senior management. Senior management does not understand the scope of the project. How would the project manager explain the situation?
  • 26.
    Question 3 When didyour organization or team last have a meaningful project review or evaluation? • During the last ice age or earlier – 0 pts • When something exploded, someone killed, etc. - 1 pts • When we completed our last project - 4 pts
  • 27.
    Question 4 Do youuse an iterative project development process in your organization? • What is an iterative project development process? – 0 pts • For some projects, if necessary - 1 pts • This is how we manage complex projects - 4 pts
  • 28.
    Adaptive Management “Maturity Assessment” •0 – 8 – Your projects will benefit from adaptive management practices as soon as they are established in your organization • 8 – 12 – Your organizational culture supports adaptive management, but there is opportunity for improvement • 12 – 16 – You probably don’t need to be at this presentation: your organization already has good adaptive management processes.
  • 29.
    Recommendations 1. Whenever possible,do not define a detailed project plan upfront, instead use an iterative project management approach. 2. Always identify multiple project alternatives or hypotheses; model these alternatives; and if it is deemed beneficial, start implementing a few alternatives at the same time. 3. Use quantitative risk analysis at each phase and iteration of the project.
  • 30.
    Recommendations 4. Integrate originalassumptions and new learnings when planning next project iterations. 5. Try to minimize the cost of decision reversals; minimize risk by keeping the option to change project direction available. 6. Ensure that adaptive management is implemented within a creative business environment, which is characterized by a collaborative structure for stakeholder participation and learning.
  • 31.
    Additional Resources 31 Project Think: WhyGood Managers Make Poor Project Choices Project Decisions: The Art and Science Introduction to Project Risk Management and Decision Analysis Project Risk Analysis Made Ridiculously Simple
  • 32.
