Name: NITIN GUPTA
Mobile No: +91-9810038093
Email: engineernitin1980@gmail.com
Current Location: Gurgaon, India
Preferred Location: Jammu (J&K), India
Objective
To develop a common domain of expertise across sectors such as real estate,
Infrastructure, retail, logistics etc by working in fields such as Strategic planning &
Project control, Business development, Contracts, Project management, Risk
management, Marketing and finance, Liaisoning etc which cut across these sectors.
Professional Qualifications
Post Graduate Diploma in Advanced Construction Management from NICMAR
(National Institute of Construction Management and Research) Pune,
Maharashtra, India: Passed out in Jan 2006
Bachelor of Civil Engineering from University of Pune, Maharashtra, India
(K K Wagh Engineering College, Nasik): Passed out with a First Class in June 2003
Area of Specialization
Hands on experience in various NHAI projects in different capacities i.e. Site
Planning, Co-ordination, Procurement & Contracts mgmt., Liasioning with Govt. &
Private players
To create, manage and maintain warm and positive relationships with people who
are policy makers, decision-makers and at levels in Govt./Ministries/Governing
bodies, consultants, architects, contractors, quantity surveyors, project-owners,
banks for enduring and enlarging our business in short, medium and long term
perspectives, achieve targets for sustained growth of the company for better returns
to all the stake holders.
Project planning /Project Mgmt. for Large scale projects in Highways including BOT
Projects on EPC mode, Airports, High rise buildings, Metros, Steel & power plant.
President & CEO’s office: Preparing annual business plans, Strategic planning,
Corporate planning, Budgeting & Cash flow mgmt., PPT for Board meetings etc.
Total all round Work Experience
More than 9 years of experience with two of the best construction companies in India
to work with. a) Punjlloyd Limited & b) Jindal Steel & Power Limited.
Computer Proficiency
MS-project, PRIMAVERA, ERP, Oracle, Financial Modeling to work out the IRR of
the Project, SAP.
References
Available on request

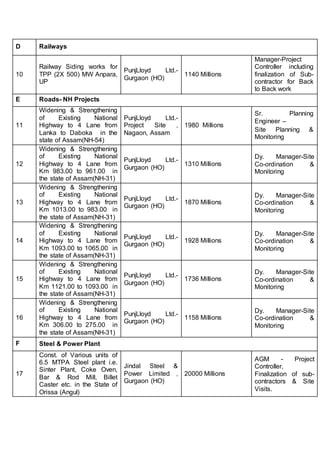

Major Project Executed:
S.No Name of Project
Organization
Worked with
Value of Project Profile
A High Rise Buildings, Group Housing, Commercial Complex & Hospitals
1
Cons. of Two Residential
towers of 21 Storey each
for HIRCO , Mumbai
PunjLloyd Ltd.-
Gurgaon (HO)
2410 Millions
Manager-Project
Controller
2
Cons. of Integrated
Residential & Retail
Complex ,Capital Heights ,
for Tata Realty, Nagpur
PunjLloyd Ltd.-
Gurgaon (HO)
1952 Millions
Manager-Project
Co-ordination &
Monitoring
3
Delhi Police Housing
Project, Dheerpur,
New Delhi.
PunjLloyd Ltd.-
Gurgaon (HO)
8250 Millions
Manager-Project
Co-ordination &
Monitoring
4
Cons. of 3 Hospitals for
West Bengal Medical
services Corporation Ltd.
PunjLloyd Ltd.-
Gurgaon (HO)
2750 Millions
Manager-Project
Co-ordination &
Monitoring
5 AIIMS-College- Raipur
PunjLloyd Ltd.-
Gurgaon (HO)
1150 Millions
Dy. Manager-Site
Co-ordination &
Monitoring
6
Rajiv Gandhi Institute of
petroleum Technology at
Ray Bareli
PunjLloyd Ltd.-
Gurgaon (HO)
1890 Millions
Dy. Manager-Site
Co-ordination &
Monitoring
7
Cons. of Medanta Hospital
,Gurgaon
PunjLloyd Ltd.-
Gurgaon (HO)
1650 Millions
Sr. Engineer –
Project Planning &
Monitoring
B Airports
8
Cons. of New Airport at
Pakyong , Sikkim
PunjLloyd Ltd.-
Gurgaon (HO)
2640 Millions
Dy. Manager –
Project Planning,
Procurement &
Monitoring
C Metro Stations
9
Elevated Metro Stations –
3 Packages constitute of 8
Metro Stations , Bangalore
PunjLloyd Ltd.-
Gurgaon (HO)
3080 Millions
Dy. Manager –
Project Planning,
Site Co-ordination &
Monitoring
D Railways
10
Railway Siding works for
TPP (2X 500) MW Anpara,
UP
PunjLloyd Ltd.-
Gurgaon (HO)
1140 Millions
Manager-Project
Controller including
finalization of Sub-contractor
for Back
to Back work
E Roads- NH Projects
11
Widening & Strengthening
of Existing National
Highway to 4 Lane from
Lanka to Daboka in the
state of Assam(NH-54)
PunjLloyd Ltd.-
Project Site ,
Nagaon, Assam
1980 Millions
Sr. Planning
Engineer –
Site Planning &
Monitoring
12
Widening & Strengthening
of Existing National
Highway to 4 Lane from
Km 983.00 to 961.00 in
the state of Assam(NH-31)
PunjLloyd Ltd.-
Gurgaon (HO)
1310 Millions
Dy. Manager-Site
Co-ordination &
Monitoring
13
Widening & Strengthening
of Existing National
Highway to 4 Lane from
Km 1013.00 to 983.00 in
the state of Assam(NH-31)
PunjLloyd Ltd.-
Gurgaon (HO)
1870 Millions
Dy. Manager-Site
Co-ordination &
Monitoring
14
Widening & Strengthening
of Existing National
Highway to 4 Lane from
Km 1093.00 to 1065.00 in
the state of Assam(NH-31)
PunjLloyd Ltd.-
Gurgaon (HO)
1928 Millions
Dy. Manager-Site
Co-ordination &
Monitoring
15
Widening & Strengthening
of Existing National
Highway to 4 Lane from
Km 1121.00 to 1093.00 in
the state of Assam(NH-31)
PunjLloyd Ltd.-
Gurgaon (HO)
1736 Millions
Dy. Manager-Site
Co-ordination &
Monitoring
16
Widening & Strengthening
of Existing National
Highway to 4 Lane from
Km 306.00 to 275.00 in
the state of Assam(NH-31)
PunjLloyd Ltd.-
Gurgaon (HO)
1158 Millions
Dy. Manager-Site
Co-ordination &
Monitoring
F Steel & Power Plant
17
Const. of Various units of
6.5 MTPA Steel plant i.e.
Sinter Plant, Coke Oven,
Bar & Rod Mill, Billet
Caster etc. in the State of
Orissa (Angul)
Jindal Steel &
Power Limited ,
Gurgaon (HO)
20000 Millions
AGM - Project
Controller,
Finalization of sub-contractors
& Site
Visits.
Work History
July 2013 till date: Presently working with Jindal Steel &
Power Limited in the Office of President
Const. –EPC as Asst. General Manager
(Project Controller)
Functional Area:
 To check & give inputs on Project estimate of various units of Steel, Hydro &
Thermal power plants which are in the preliminary stage of construction at
various locations across pan India & abroad.
 Spearheading Special Initiatives: Integration of a new SBU into JSPL family,
Employee Engagement Initiatives.
 Planned and facilitated various internal Senior Management Forums, budget
and strategy plan exercise, review meetings etc and catalyzed implementation
of decisions taken in letter and spirit.
 To finalize Sub-contractors for Large value works which requires huge labour.
This is a very tedious job as there is huge shortage of labour in Orissa (Angul)
region.
 Liaisoning with Client/Govt. agencies for Labour licenses, Environmental
clearance, clearing of RA Bills on time for maintaining positive cashflow.
Oct 2010 to June 2013: With PunjLloyd Limited as Manager
(Head of MIS) & Executive Asst. to
President & CEO (B&I)
Functional Area:
 Responsible for preparation of Business Plan for the entire Vertical and
review it on Monthly/Quarterly/6 months/Yearly basis.
 Interaction with various clients for future/upcoming projects.Liasioning with
Govt. agencies/ministries.
 Preparing various presentations for CEO's office for Board level meetings
clearly showing the Profitability, Cash flows, Turnover for the entire vertical.
 SWOT analysis followed by Strategy Formulation.
 To ensure that the Project Budget for each ongoing project should be
prepared on yearly basis and review of the same will be done on
monthly/quarterly/6months/Yearly basis.
Aug 2008– Sep2010: With PunjLloyd Limited as Dy. Manager
(Corporate Planning, Co-ordination &
Monitoring) for B&I Vertical with Projects
worth CV 1700 Crs.
Functional Area:
 Complete Project Management including Budgeting, Mobilization of all
resources, their scheduling, Work Planning and implementation to complete
the Project within scheduled time and cost parameters.
 Use of Control Charts, Close monitoring for Project Completion within Target
Time Completion as well Limited Budget Allocated.
 Preparation of various Project Management Reports such as Profitability
Statement, Material Reconciliation report, Fixed Monthly Expenses, HSD
consumption reports etc.
 Look Ahead/Catch-up Program, Standardization of Reporting Format,
Training & Post –implementation support.
 Preparation of Construction Schedule along with Manpower & Machinery
forecast for Tendering.

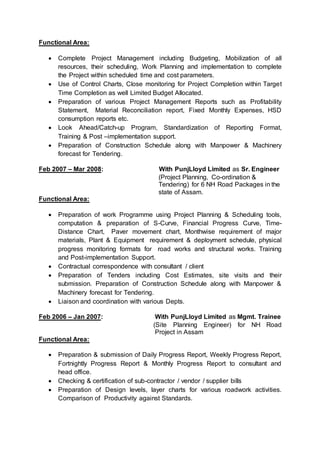

Feb 2007 – Mar 2008: With PunjLloyd Limited as Sr. Engineer
(Project Planning, Co-ordination &
Tendering) for 6 NH Road Packages in the
state of Assam.
Functional Area:
 Preparation of work Programme using Project Planning & Scheduling tools,
computation & preparation of S-Curve, Financial Progress Curve, Time-
Distance Chart, Paver movement chart, Monthwise requirement of major
materials, Plant & Equipment requirement & deployment schedule, physical
progress monitoring formats for road works and structural works. Training
and Post-implementation Support.
 Contractual correspondence with consultant / client
 Preparation of Tenders including Cost Estimates, site visits and their
submission. Preparation of Construction Schedule along with Manpower &
Machinery forecast for Tendering.
 Liaison and coordination with various Depts.
Feb 2006 – Jan 2007: With PunjLloyd Limited as Mgmt. Trainee
(Site Planning Engineer) for NH Road
Project in Assam
Functional Area:
 Preparation & submission of Daily Progress Report, Weekly Progress Report,
Fortnightly Progress Report & Monthly Progress Report to consultant and
head office.
 Checking & certification of sub-contractor / vendor / supplier bills
 Preparation of Design levels, layer charts for various roadwork activities.
Comparison of Productivity against Standards.

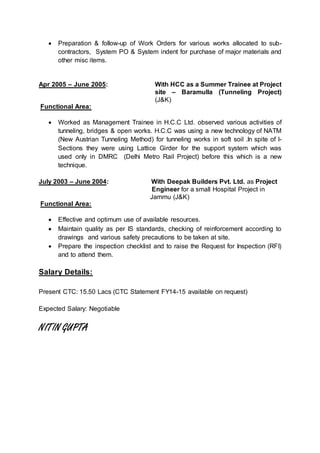

 Preparation & follow-up of Work Orders for various works allocated to sub-contractors,
System PO & System indent for purchase of major materials and
other misc items.
Apr 2005 – June 2005: With HCC as a Summer Trainee at Project
site – Baramulla (Tunneling Project)
(J&K)
Functional Area:
 Worked as Management Trainee in H.C.C Ltd. observed various activities of
tunneling, bridges & open works. H.C.C was using a new technology of NATM
(New Austrian Tunneling Method) for tunneling works in soft soil .In spite of I-Sections
they were using Lattice Girder for the support system which was
used only in DMRC (Delhi Metro Rail Project) before this which is a new
technique.
July 2003 – June 2004: With Deepak Builders Pvt. Ltd. as Project
Engineer for a small Hospital Project in
Jammu (J&K)
Functional Area:
 Effective and optimum use of available resources.
 Maintain quality as per IS standards, checking of reinforcement according to
drawings and various safety precautions to be taken at site.
 Prepare the inspection checklist and to raise the Request for Inspection (RFI)
and to attend them.
Salary Details:
Present CTC: 15.50 Lacs (CTC Statement FY14-15 available on request)
Expected Salary: Negotiable
