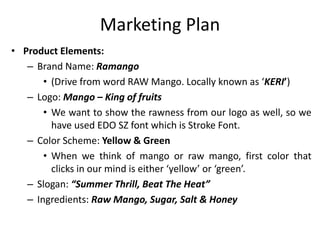

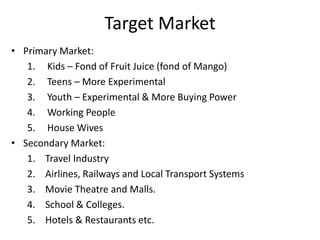

This document presents a project proposal for a juice extraction and packaging company called Best Beverages (Pvt.) Ltd. The company will produce the juice drink "SummerThrill,Beat The Heat" under the brand name Ramango. Key details include:

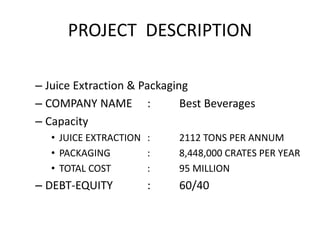

- The plant will be located in Karachi and have a capacity of extracting 2,112 tons of juice and packaging 8.448 million crates annually.

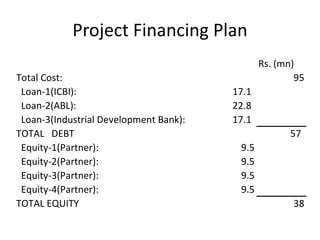

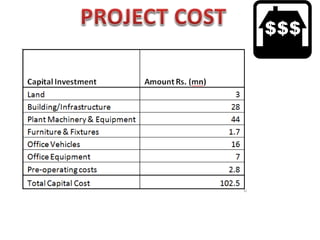

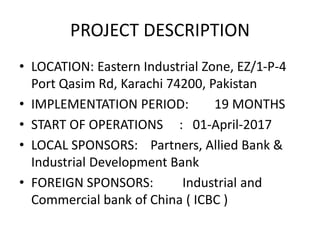

- Total project cost is Rs. 95 million to be financed with 60% debt and 40% equity. Debt will come from three banks and equity from four partners.

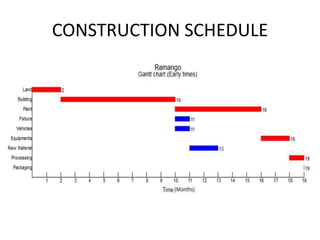

- Construction is scheduled to take 19 months to be completed by April 2017.

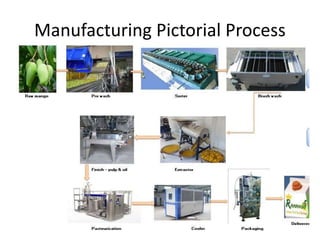

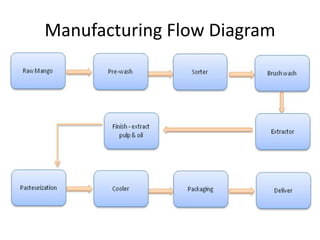

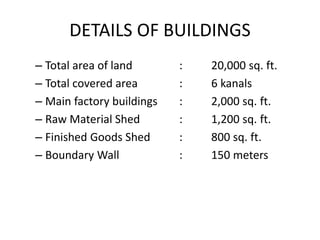

- The management team, factory layout, machinery
