breaking through barriers to progress
Plant Maintenance in SAP
A functional perspective
an award winning '2004 Future 50 Company'
By – Gopinath
18650 W. Corporate Drive Suite 120 Brookfield, WI 53045 262.792.0200
SAP R/3 - Overview
Getting Started
 SAP AG
R

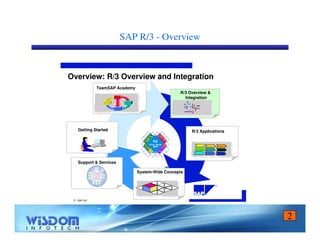

Overview: R/3 Overview and Integration
R//3
SD
Salless
Distribution
MMatteerriiallss
MMggmmtt
Client / Serrverr
ABAP
CO
Conttrrolllliing
AM
Asssett MMgmmtt
PPSS
Project
Systtem
WFF
Workflow
IIS
Industry
SSoolluuttiioonnss
MM
HR
Human
Resources
PPPP
Production
PPllaanniinng
QM
Quality
Mgmt
FII
Financial
Accounttiing
PM
Pllantt Maiinn--
ttennancce
System-Wide Concepts
TeamSAP Academy
R/3 Overview
Integration
R/3 Applications
Support  Services
2
3
Plant Maintenance - Overview
SD
Sales
Distrib.
Logistics Accounting
 SAP AG
R

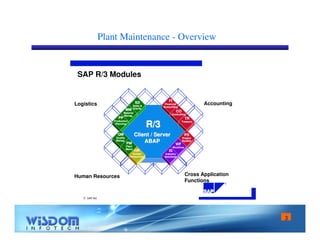

SAP R/3 Modules
Human Resources
Cross Application
Functions
R//3
Client / Server
ABAP
FII
Financial
Accounting
CO
Controlling
TR
Treasury
PS
Project
System
WF
Workflow
IIS
Industry
Solutions
MM
Material
Manag.
HR
Human
Resources.
PP
Production
Planning
QM
Quality
Manag.
PM
Plant
Maint.
4
Plant Maintenance - Overview

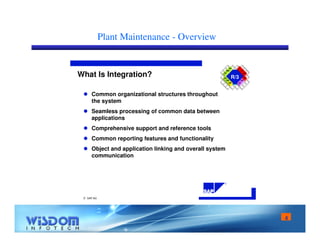

R/3 What Is Integration?
 SAP AG
R
SD
MM
PP
QA
PM
HR
FI
CO
AM
PS
WF
IS
 Common organizational structures throughout
the system
 Seamless processing of common data between
applications
 Comprehensive support and reference tools
 Common reporting features and functionality
 Object and application linking and overall system
communication
5

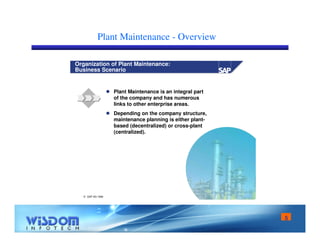

Plant Maintenance - Overview
Organization of Plant Maintenance:
Business Scenario
 SAP AG 1999
 Plant Maintenance is an integral part
of the company and has numerous
links to other enterprise areas.
 Depending on the company structure,
maintenance planning is either plant-based
(decentralized) or cross-plant
(centralized).
6
Plant Maintenance - Overview
Structure of Plant Maintenance
 SAP AG 1999
EQM Technical Data
Functional locations
Equipment
Assemblies
Bills of material
Networks of technical objects
PRM Preventive Maintenance
Task lists
Maintenance plans
WOC Maintenance Processing
Maintenance notifications
Maintenance orders
PMIS Plant Maintenance Information System
CRP Work Centers and Capacity
Maintenance work centers
7
Plant Maintenance - Overview

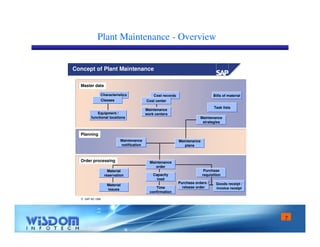

Concept of Plant Maintenance
 SAP AG 1999
Bills of material
Task lists
Characteristics
Classes
Equipment /
functional locations
Cost records
Cost center
Maintenance
work centers
Maintenance
notification
Material
reservation
Material
issues
Maintenance
order
Capacity
load
Time
confirmation
Maintenance
strategies
Purchase
requisition
Maintenance
plans
Master data
Planning
Order processing
Goods receipt /
invoice receipt
Purchase orders /
release order
8

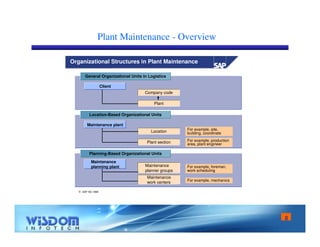

Plant Maintenance - Overview
Organizational Structures in Plant Maintenance
General Organizational Units in Logistics
Company code
Plant
Location-Based Organizational Units
Maintenance plant
Location
Plant section
Planning-Based Organizational Units
 SAP AG 1999
For example, site,
building, coordinate
For example, production
area, plant engineer
Client
Maintenance
planning plant
Maintenance
work centers
For example, foreman,
work scheduling
For example, mechanics
Maintenance
planner groups
9

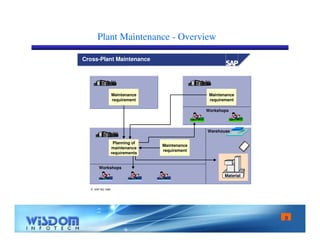

Plant Maintenance - Overview
Cross-Plant Maintenance
 SAP AG 1999
Plant 1200 Plant 1300
Maintenance
requirement
Plant 1000
Workshops
Workshops
Maintenance
requirement
Planning of
maintenance
requirements
Maintenance
requirement
Warehouse
Material
10
Plant Maintenance - Overview
Maintenance Work Centers
 SAP AG 1999
Maintenance work centers
For example:
Welding
Metalworking
Mechanics
11
Plant Maintenance - Overview

Work Center: Contents
 Basic data
 SAP AG 1999
 General data
 Capacity data
 Capacity categories
 Scheduling
 Capacity / pool capacity
 Available capacity profile
T i m e
Links  Activity types
 Activity types
 Cost center
 Work center
 Person
 Qualification
 Staffing assignment
 Staffing assignment
 Activity types
 Staffing assignment
12

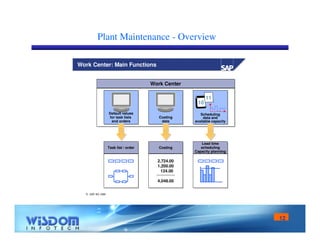

Plant Maintenance - Overview
Work Center: Main Functions
 SAP AG 1999
WWoorrkk CCeenntteerr
Costing
data
Costing
data
Default values
for task lists
and orders
Default values
for task lists
and orders
10
11
Scheduling
data and
Scheduling
data and
available capacity
available capacity
CCoossttiinngg
2,724.00
1,200.00
124.00
2,724.00
1,200.00
124.00
4,048.00
4,048.00
TTaasskk lliisstt // oorrddeerr
Lead time
scheduling
Lead time
scheduling
Capacity planning
Capacity planning
13

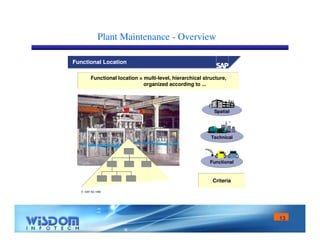

Plant Maintenance - Overview
Functional location = multi-level, hierarchical structure,
 SAP AG 1999
Spatial
Technical
Functional
organized according to ...
Criteria
Functional Location
14

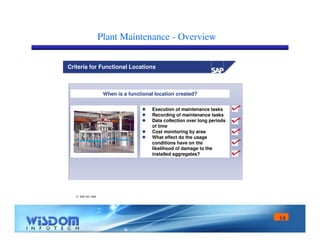

Plant Maintenance - Overview
Criteria for Functional Locations
 SAP AG 1999
When is a functional location created?
 Execution of maintenance tasks
 Recording of maintenance tasks
 Data collection over long periods
of time
 Cost monitoring by area
 What effect do the usage
conditions have on the
likelihood of damage to the
installed aggregates?
15
Plant Maintenance - Overview

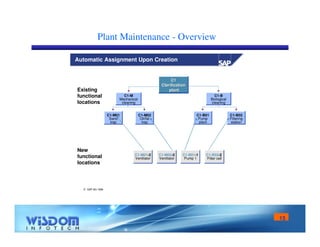

Automatic Assignment Upon Creation
 SAP AG 1999
C1-B
Biological
cleaning
C1
Clarification
plant
C1-M
Mechanical
cleaning
C1-M01
Sand
trap
C1-M02
Oil/fat
trap
C1-B01
Pump
plant
C1-B02
Filtering
station
Existing
functional
locations
New
functional
locations
C1-C1-M01-M01-2
2
Ventilator
Ventilator
C1-M02-2
Ventilator
C1-B01-1
Pump 1
C1-B02-2
Filter cell
16

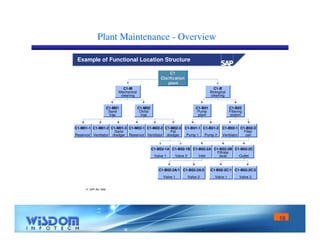

Plant Maintenance - Overview
Example of Functional Location Structure
 SAP AG 1999
C1-B
Biological
cleaning
C1
Clarification
plant
C1-M01-1
Reservoir
C1-M01-2
Ventilator
C1-M01-3
Sand
dredger
C1-M02-1
Reservoir
C1-M02-2
Ventilator
C1-M02-3
Fat
dredger
C1-B01-1
Pump 1
C1-B01-2
Pump 2
C1-B02-1
Ventilator
C1-B02-2
Filter
cell
C1-M
Mechanical
cleaning
C1-M01
Sand
trap
C1-B02-1A
Valve 1
C1-B02-1B
Valve 2
C1-B02-2A
Inlet
C1-B02-2B
Filtrate
level
C1-B02-2C
Outlet
C1-M02
Oil/fat
trap
C1-B01
Pump
plant
C1-B02
Filtering
station
C1-B02-2A/1
Valve 1
C1-B02-2A/2
Valve 2
C1-B02-2C/1
Valve 1
C1-B02-2C/2
Valve 2
17
Plant Maintenance - Overview
Criteria for Equipment Master Record
 SAP AG 1999
When is a piece of equipment created?
 Management of individual data
 Recording of maintenance tasks
 Object-based recording of costs
 Evaluation of technical data
 Recording of usage times
18

Plant Maintenance - Overview
Equipment Master Record
Equipment maasstteerr rreeccoorrdd
 SAP AG 1999
Equiipmentt usage
Documentts //
ttechniicall drawiings
Mullttiilliinguall ttextts
Measuriing poiintts //
countters
IIntternall notte
Location A
Location B
Cllassiiffiicattiion List
X
X
X
X
X
X
X
Address // parttner
Permiitts
0 4 7 1
0 1 2 3
GGeenneerraall
LLooccaattiioonn
OOrrggaanniizzaattiioonn
SSttrruuccttuurree
19

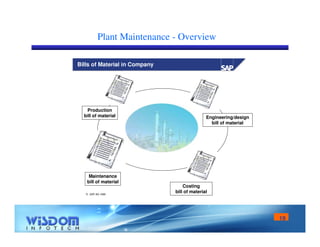

Plant Maintenance - Overview
Bills of Material in Company
Production
bill of material
 SAP AG 1999
Engineering/design
bill of material
Costing
bill of material
Maintenance
bill of material
20
Plant Maintenance - Overview
Breakdown Maintenance: Business Scenario
 SAP AG 1999
 For breakdown maintenance, the
data required for the other business
processes needs to entered quickly
and easily so that the subsequent
steps can be executed.
21

Plant Maintenance - Overview

Business Process: Breakdown Maintenance
1
 SAP AG 1999
NNoottiiffiiccaattiioonn
PPllaannnniinngg
SScchheedduulliinngg
EExxeeccuuttiioonn
CCoompplleettiioonn
• Technical object
• Description
• Work to be performed
• Internal/external resources
History
• Date
• Malfunction
Material PMIS, list
Material usage, orders, notifications, PMIS, usage list
• Material
• Tools
• Capacity leveling
• Availability check
• Order release
• Printout
• Planned/unplanned material withdrawal
• External procurement
1
44
55
22
33
22
33
• Time confirmation
• Technical completion
• Order settlement
• Technical confirmation
22

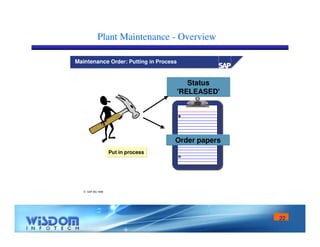

Plant Maintenance - Overview
Maintenance Order: Putting in Process
 SAP AG 1999
Status
'RELEASED'
Order papers
Put in process
23

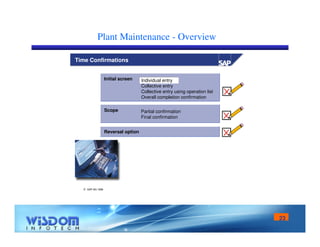

Plant Maintenance - Overview
Time Confirmations
 SAP AG 1999
Initial screen
Partial confirmation
Final confirmation
Scope
Reversal option
Individual entry
Collective entry
Collective entry using operation list
Overall completion confirmation
24
Plant Maintenance - Overview

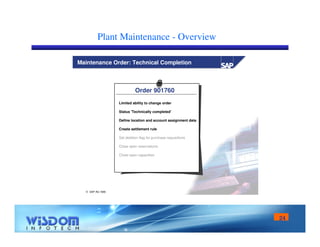

Maintenance Order: Technical Completion
 SAP AG 1999
Order 901760
Limited ability to change order
Status 'Technically completed'
Define location and account assignment data
Create settlement rule
Set deletion flag for purchase requisitions
Close open reservations
Close open capacities
25

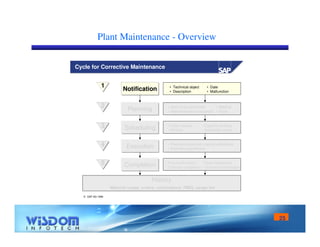

Plant Maintenance - Overview

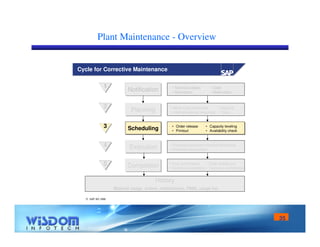

Cycle for Corrective Maintenance
1
2
3
 SAP AG 1999
Notification
Planning
Scheduling
Execution
Completion
• Technical object
• Description
• Work to be performed
• Internal/external resources
History
• Date
• Malfunction
Material usage, orders, notifications, PMIS, usage list
• Material
• Tools
• Capacity leveling
• Availability check
• Order release
• Printout
• Planned/unplanned material withdrawal
• External procurement
• Time confirmation
• Technical completion
• Order settlement
• Technical confirmation
4
5
26

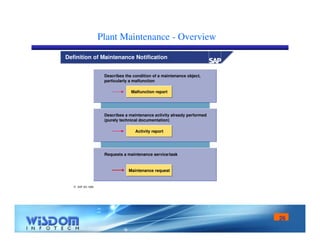

Plant Maintenance - Overview
Definition of Maintenance Notification
 SAP AG 1999
Describes the condition of a maintenance object,
particularly a malfunction
Malfunction report
Describes a maintenance activity already performed
(purely technical documentation)
Activity report
Requests a maintenance service/task
Maintenance request
27
Plant Maintenance - Overview
Maintenance Notification: Structure
 SAP AG 1999
Date / time / reported by
Description
Object: Functional location
Equipment
Assembly
Material serial number
Location data
Breakdown / availability
Activity
Execution factors
Activities
Dates
Task description
Tasks
Damage location
Damage
Cause of damage
NotifTiceaxttion
items
Notification
28

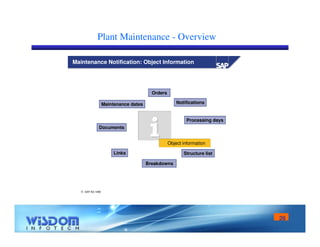

Plant Maintenance - Overview
Maintenance Notification: Object Information
 SAP AG 1999
Maintenance dates Notifications
ii
Processing days
Object information
Documents
Links
Breakdowns
Structure list
Orders
29
Plant Maintenance - Overview
Select Maintenance Notifications
Why ?
Find particular maintenance notification
Process several maintenance
notifications simultaneously
Restrict planning worklist
 SAP AG 1999
Different sorting
Select / delete complete list
Different list fields, internal display variant
Display breakdowns graphically
Excel processing
Scope
Notification
Notification items
Tasks
Customizing
Selection conditions
Field selection
Functions
30
Plant Maintenance - Overview
Print Maintenance Notifications
 SAP AG 1999
Maintenance
notification
Notification
overview
Breakdown
report
Activity
report
Fax transfer
31
Plant Maintenance - Overview
Cycle for Corrective Maintenance
1
3
 SAP AG 1999
Notification
Scheduling
Execution
Completion
• Technical object
• Description
• Order release
• Printout
• Planned/unplanned material withdrawal
• External procurement
• Time confirmation
• Technical completion
History
• Date
• Malfunction
• Capacity leveling
• Availability check
• Order settlement
• Technical confirmation
Material usage, orders, notifications, PMIS, usage list
4
5
PPllaannnniinngg • Work to be performed
• Internal/external resources
• Material
• Tools
2
32
Plant Maintenance - Overview
Creation of Maintenance Orders
 SAP AG 1999
Maintenance order / notification
Direct creation
of order
Maintenance
notification
Maintenance
order
Creation of order
based on notification
Maintenance
notification
Maintenance
item
Maintenance
order
Automatic generation of
maintenance order
from maintenance item
Maintenance
notification
Maintenance
notification
Maintenance
order
Combination of
maintenance notifications
for maintenance order
Maintenance
notification
Maintenance
order
Entry of order with
subsequent activity report
33
Plant Maintenance - Overview
Characteristics of Maintenance Orders
 SAP AG 1999
Flexibility of order processing
Object reference
Single object
Object list
Period of validity
Single order
Standing order
Execution
Internal processing
External processing

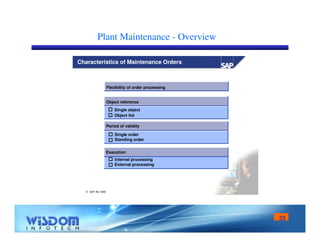

34
Plant Maintenance - Overview
Stock Material - Process Flow
Component
assignment
 SAP AG 1999
Material
reservation
May
Availability
check
Goods
issue
Printing
Order
release
Automatic
availability
check May
35
Plant Maintenance - Overview
Cycle for Corrective Maintenance
1
2
 SAP AG 1999
Notification
Planning
Execution
Completion
• Technical object
• Description
• Date
• Malfunction
• Work to be performed
• Internal/external resources
History
Material usage, orders, notifications, PMIS, usage list
• Material
• Tools
• Planned/unplanned material withdrawal
• External procurement
• Time confirmation
• Technical completion
• Order settlement
• Technical confirmation
4
5
SScchheedduulliinngg • Capacity leveling
• Availability check
• Order release
• Printout
33
36
Plant Maintenance - Overview
 SAP AG 1999
Stock
profile
Inward stock
movement
from purchase
order
Material withdrawal
for cost center
Stock transfer
to other plant
Inward stock movement
from internal production
Plant
stock
Today Requirement date
Safety
stock
Maximum
ATP quantity
Resource Planning: Availability Check
37
Plant Maintenance - Overview
Maintenance Order: Printing
 SAP AG 1999
Maintenance
order Fax transfer
Job ticket
Operation
control ticket
Pick list
Material
withdrawal
slip
Confirmation
slip
Time ticket
Object list
38
Plant Maintenance - Overview
Order Completion Confirmation: Times / Activities
 SAP AG 1999
Times
Individual entry
Collective entry
Overall completion confirmation
Time sheet (CATS)
Activities
Activity reports
Overall completion confirmation
Confirmation texts
Object changes
Measurement readings
39
Plant Maintenance - Overview
•Questions ??
•Contact Details :
mail id : gthangavelu@darylflood.com
Cell : 469-879-4674
Residence : 972-444-8510

Plant maint

  • 1.
    breaking through barriersto progress Plant Maintenance in SAP A functional perspective an award winning '2004 Future 50 Company' By – Gopinath 18650 W. Corporate Drive Suite 120 Brookfield, WI 53045 262.792.0200
  • 2.
    SAP R/3 -Overview Getting Started SAP AG R Overview: R/3 Overview and Integration R//3 SD Salless Distribution MMatteerriiallss MMggmmtt Client / Serrverr ABAP CO Conttrrolllliing AM Asssett MMgmmtt PPSS Project Systtem WFF Workflow IIS Industry SSoolluuttiioonnss MM HR Human Resources PPPP Production PPllaanniinng QM Quality Mgmt FII Financial Accounttiing PM Pllantt Maiinn-- ttennancce System-Wide Concepts TeamSAP Academy R/3 Overview Integration R/3 Applications Support Services 2
  • 3.
    3 Plant Maintenance- Overview SD Sales Distrib. Logistics Accounting SAP AG R SAP R/3 Modules Human Resources Cross Application Functions R//3 Client / Server ABAP FII Financial Accounting CO Controlling TR Treasury PS Project System WF Workflow IIS Industry Solutions MM Material Manag. HR Human Resources. PP Production Planning QM Quality Manag. PM Plant Maint.
  • 4.
    4 Plant Maintenance- Overview R/3 What Is Integration? SAP AG R SD MM PP QA PM HR FI CO AM PS WF IS Common organizational structures throughout the system Seamless processing of common data between applications Comprehensive support and reference tools Common reporting features and functionality Object and application linking and overall system communication
  • 5.
    5 Plant Maintenance- Overview Organization of Plant Maintenance: Business Scenario SAP AG 1999 Plant Maintenance is an integral part of the company and has numerous links to other enterprise areas. Depending on the company structure, maintenance planning is either plant-based (decentralized) or cross-plant (centralized).
  • 6.
    6 Plant Maintenance- Overview Structure of Plant Maintenance SAP AG 1999 EQM Technical Data Functional locations Equipment Assemblies Bills of material Networks of technical objects PRM Preventive Maintenance Task lists Maintenance plans WOC Maintenance Processing Maintenance notifications Maintenance orders PMIS Plant Maintenance Information System CRP Work Centers and Capacity Maintenance work centers
  • 7.
    7 Plant Maintenance- Overview Concept of Plant Maintenance SAP AG 1999 Bills of material Task lists Characteristics Classes Equipment / functional locations Cost records Cost center Maintenance work centers Maintenance notification Material reservation Material issues Maintenance order Capacity load Time confirmation Maintenance strategies Purchase requisition Maintenance plans Master data Planning Order processing Goods receipt / invoice receipt Purchase orders / release order
  • 8.
    8 Plant Maintenance- Overview Organizational Structures in Plant Maintenance General Organizational Units in Logistics Company code Plant Location-Based Organizational Units Maintenance plant Location Plant section Planning-Based Organizational Units SAP AG 1999 For example, site, building, coordinate For example, production area, plant engineer Client Maintenance planning plant Maintenance work centers For example, foreman, work scheduling For example, mechanics Maintenance planner groups
  • 9.
    9 Plant Maintenance- Overview Cross-Plant Maintenance SAP AG 1999 Plant 1200 Plant 1300 Maintenance requirement Plant 1000 Workshops Workshops Maintenance requirement Planning of maintenance requirements Maintenance requirement Warehouse Material
  • 10.
    10 Plant Maintenance- Overview Maintenance Work Centers SAP AG 1999 Maintenance work centers For example: Welding Metalworking Mechanics
  • 11.
    11 Plant Maintenance- Overview Work Center: Contents Basic data SAP AG 1999 General data Capacity data Capacity categories Scheduling Capacity / pool capacity Available capacity profile T i m e Links Activity types Activity types Cost center Work center Person Qualification Staffing assignment Staffing assignment Activity types Staffing assignment
  • 12.
    12 Plant Maintenance- Overview Work Center: Main Functions SAP AG 1999 WWoorrkk CCeenntteerr Costing data Costing data Default values for task lists and orders Default values for task lists and orders 10 11 Scheduling data and Scheduling data and available capacity available capacity CCoossttiinngg 2,724.00 1,200.00 124.00 2,724.00 1,200.00 124.00 4,048.00 4,048.00 TTaasskk lliisstt // oorrddeerr Lead time scheduling Lead time scheduling Capacity planning Capacity planning
  • 13.
    13 Plant Maintenance- Overview Functional location = multi-level, hierarchical structure, SAP AG 1999 Spatial Technical Functional organized according to ... Criteria Functional Location
  • 14.
    14 Plant Maintenance- Overview Criteria for Functional Locations SAP AG 1999 When is a functional location created? Execution of maintenance tasks Recording of maintenance tasks Data collection over long periods of time Cost monitoring by area What effect do the usage conditions have on the likelihood of damage to the installed aggregates?
  • 15.
    15 Plant Maintenance- Overview Automatic Assignment Upon Creation SAP AG 1999 C1-B Biological cleaning C1 Clarification plant C1-M Mechanical cleaning C1-M01 Sand trap C1-M02 Oil/fat trap C1-B01 Pump plant C1-B02 Filtering station Existing functional locations New functional locations C1-C1-M01-M01-2 2 Ventilator Ventilator C1-M02-2 Ventilator C1-B01-1 Pump 1 C1-B02-2 Filter cell
  • 16.
    16 Plant Maintenance- Overview Example of Functional Location Structure SAP AG 1999 C1-B Biological cleaning C1 Clarification plant C1-M01-1 Reservoir C1-M01-2 Ventilator C1-M01-3 Sand dredger C1-M02-1 Reservoir C1-M02-2 Ventilator C1-M02-3 Fat dredger C1-B01-1 Pump 1 C1-B01-2 Pump 2 C1-B02-1 Ventilator C1-B02-2 Filter cell C1-M Mechanical cleaning C1-M01 Sand trap C1-B02-1A Valve 1 C1-B02-1B Valve 2 C1-B02-2A Inlet C1-B02-2B Filtrate level C1-B02-2C Outlet C1-M02 Oil/fat trap C1-B01 Pump plant C1-B02 Filtering station C1-B02-2A/1 Valve 1 C1-B02-2A/2 Valve 2 C1-B02-2C/1 Valve 1 C1-B02-2C/2 Valve 2
  • 17.
    17 Plant Maintenance- Overview Criteria for Equipment Master Record SAP AG 1999 When is a piece of equipment created? Management of individual data Recording of maintenance tasks Object-based recording of costs Evaluation of technical data Recording of usage times
  • 18.
    18 Plant Maintenance- Overview Equipment Master Record Equipment maasstteerr rreeccoorrdd SAP AG 1999 Equiipmentt usage Documentts // ttechniicall drawiings Mullttiilliinguall ttextts Measuriing poiintts // countters IIntternall notte Location A Location B Cllassiiffiicattiion List X X X X X X X Address // parttner Permiitts 0 4 7 1 0 1 2 3 GGeenneerraall LLooccaattiioonn OOrrggaanniizzaattiioonn SSttrruuccttuurree
  • 19.
    19 Plant Maintenance- Overview Bills of Material in Company Production bill of material SAP AG 1999 Engineering/design bill of material Costing bill of material Maintenance bill of material
  • 20.
    20 Plant Maintenance- Overview Breakdown Maintenance: Business Scenario SAP AG 1999 For breakdown maintenance, the data required for the other business processes needs to entered quickly and easily so that the subsequent steps can be executed.
  • 21.
    21 Plant Maintenance- Overview Business Process: Breakdown Maintenance 1 SAP AG 1999 NNoottiiffiiccaattiioonn PPllaannnniinngg SScchheedduulliinngg EExxeeccuuttiioonn CCoompplleettiioonn • Technical object • Description • Work to be performed • Internal/external resources History • Date • Malfunction Material PMIS, list Material usage, orders, notifications, PMIS, usage list • Material • Tools • Capacity leveling • Availability check • Order release • Printout • Planned/unplanned material withdrawal • External procurement 1 44 55 22 33 22 33 • Time confirmation • Technical completion • Order settlement • Technical confirmation
  • 22.
    22 Plant Maintenance- Overview Maintenance Order: Putting in Process SAP AG 1999 Status 'RELEASED' Order papers Put in process
  • 23.
    23 Plant Maintenance- Overview Time Confirmations SAP AG 1999 Initial screen Partial confirmation Final confirmation Scope Reversal option Individual entry Collective entry Collective entry using operation list Overall completion confirmation
  • 24.
    24 Plant Maintenance- Overview Maintenance Order: Technical Completion SAP AG 1999 Order 901760 Limited ability to change order Status 'Technically completed' Define location and account assignment data Create settlement rule Set deletion flag for purchase requisitions Close open reservations Close open capacities
  • 25.
    25 Plant Maintenance- Overview Cycle for Corrective Maintenance 1 2 3 SAP AG 1999 Notification Planning Scheduling Execution Completion • Technical object • Description • Work to be performed • Internal/external resources History • Date • Malfunction Material usage, orders, notifications, PMIS, usage list • Material • Tools • Capacity leveling • Availability check • Order release • Printout • Planned/unplanned material withdrawal • External procurement • Time confirmation • Technical completion • Order settlement • Technical confirmation 4 5
  • 26.
    26 Plant Maintenance- Overview Definition of Maintenance Notification SAP AG 1999 Describes the condition of a maintenance object, particularly a malfunction Malfunction report Describes a maintenance activity already performed (purely technical documentation) Activity report Requests a maintenance service/task Maintenance request
  • 27.
    27 Plant Maintenance- Overview Maintenance Notification: Structure SAP AG 1999 Date / time / reported by Description Object: Functional location Equipment Assembly Material serial number Location data Breakdown / availability Activity Execution factors Activities Dates Task description Tasks Damage location Damage Cause of damage NotifTiceaxttion items Notification
  • 28.
    28 Plant Maintenance- Overview Maintenance Notification: Object Information SAP AG 1999 Maintenance dates Notifications ii Processing days Object information Documents Links Breakdowns Structure list Orders
  • 29.
    29 Plant Maintenance- Overview Select Maintenance Notifications Why ? Find particular maintenance notification Process several maintenance notifications simultaneously Restrict planning worklist SAP AG 1999 Different sorting Select / delete complete list Different list fields, internal display variant Display breakdowns graphically Excel processing Scope Notification Notification items Tasks Customizing Selection conditions Field selection Functions
  • 30.
    30 Plant Maintenance- Overview Print Maintenance Notifications SAP AG 1999 Maintenance notification Notification overview Breakdown report Activity report Fax transfer
  • 31.
    31 Plant Maintenance- Overview Cycle for Corrective Maintenance 1 3 SAP AG 1999 Notification Scheduling Execution Completion • Technical object • Description • Order release • Printout • Planned/unplanned material withdrawal • External procurement • Time confirmation • Technical completion History • Date • Malfunction • Capacity leveling • Availability check • Order settlement • Technical confirmation Material usage, orders, notifications, PMIS, usage list 4 5 PPllaannnniinngg • Work to be performed • Internal/external resources • Material • Tools 2
  • 32.
    32 Plant Maintenance- Overview Creation of Maintenance Orders SAP AG 1999 Maintenance order / notification Direct creation of order Maintenance notification Maintenance order Creation of order based on notification Maintenance notification Maintenance item Maintenance order Automatic generation of maintenance order from maintenance item Maintenance notification Maintenance notification Maintenance order Combination of maintenance notifications for maintenance order Maintenance notification Maintenance order Entry of order with subsequent activity report
  • 33.
    33 Plant Maintenance- Overview Characteristics of Maintenance Orders SAP AG 1999 Flexibility of order processing Object reference Single object Object list Period of validity Single order Standing order Execution Internal processing External processing
  • 34.
    34 Plant Maintenance- Overview Stock Material - Process Flow Component assignment SAP AG 1999 Material reservation May Availability check Goods issue Printing Order release Automatic availability check May
  • 35.
    35 Plant Maintenance- Overview Cycle for Corrective Maintenance 1 2 SAP AG 1999 Notification Planning Execution Completion • Technical object • Description • Date • Malfunction • Work to be performed • Internal/external resources History Material usage, orders, notifications, PMIS, usage list • Material • Tools • Planned/unplanned material withdrawal • External procurement • Time confirmation • Technical completion • Order settlement • Technical confirmation 4 5 SScchheedduulliinngg • Capacity leveling • Availability check • Order release • Printout 33
  • 36.
    36 Plant Maintenance- Overview SAP AG 1999 Stock profile Inward stock movement from purchase order Material withdrawal for cost center Stock transfer to other plant Inward stock movement from internal production Plant stock Today Requirement date Safety stock Maximum ATP quantity Resource Planning: Availability Check
  • 37.
    37 Plant Maintenance- Overview Maintenance Order: Printing SAP AG 1999 Maintenance order Fax transfer Job ticket Operation control ticket Pick list Material withdrawal slip Confirmation slip Time ticket Object list
  • 38.
    38 Plant Maintenance- Overview Order Completion Confirmation: Times / Activities SAP AG 1999 Times Individual entry Collective entry Overall completion confirmation Time sheet (CATS) Activities Activity reports Overall completion confirmation Confirmation texts Object changes Measurement readings
  • 39.
    39 Plant Maintenance- Overview •Questions ?? •Contact Details : mail id : gthangavelu@darylflood.com Cell : 469-879-4674 Residence : 972-444-8510
