I N T E R N AT I O N A L A S S O C I AT I O N O F M U S E U M F A C I L I T Y A D M I N I S T R AT O R S

      PAPYRUS                                                              VOL. 11, NO. 2   SUMMER–FALL 2010

                                                                                        Celebrating

                                                                                                Years

                                                    The 20th Annual
        IAMFA                                      IAMFA Conference                                  Reflections on
The First Twenty Years                            in San Francisco, CA                                  Papyrus

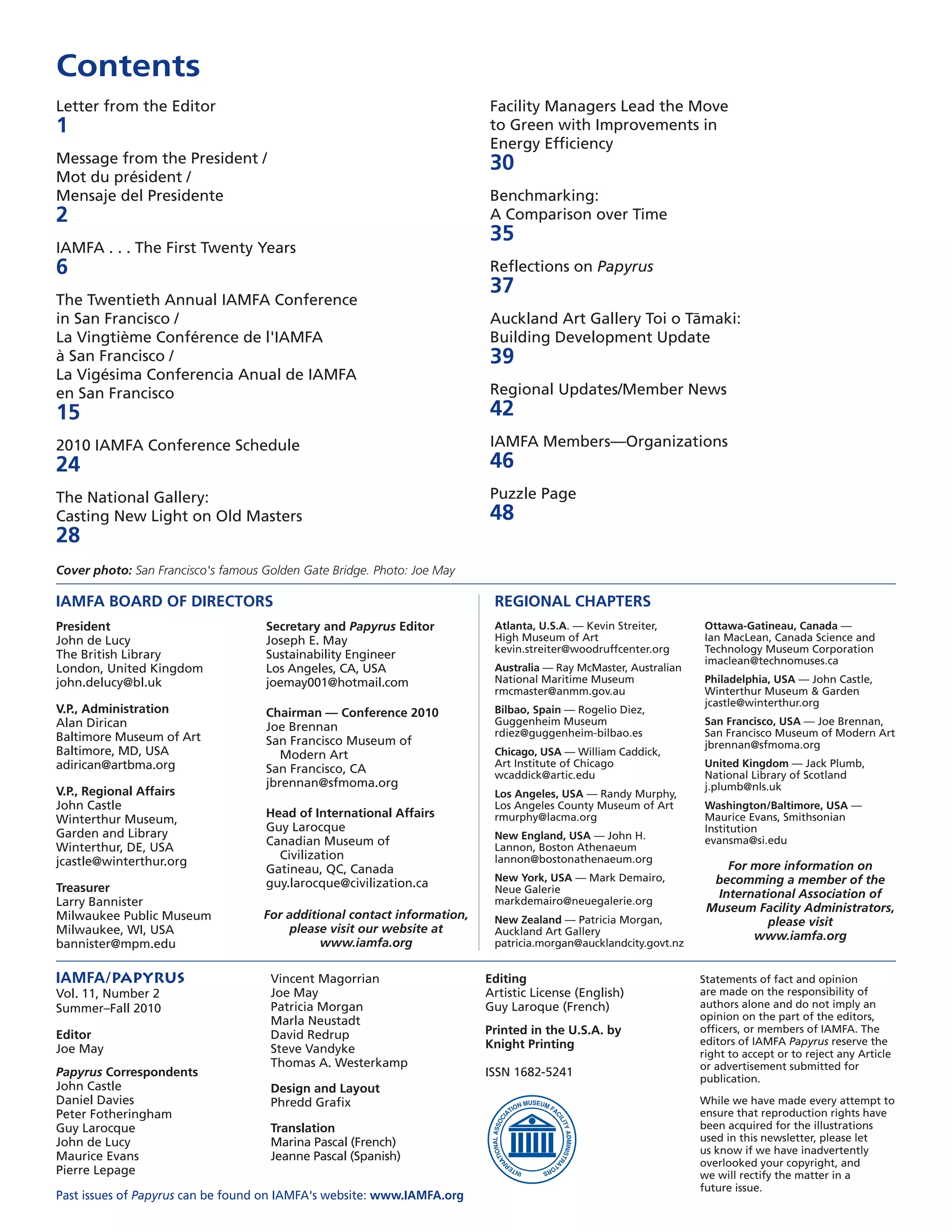

Contents
Letter from the Editor                                                    Facility Managers Lead the Move
1                                                                         to Green with Improvements in
                                                                          Energy Efficiency
Message from the President /                                              30
Mot du prƩsident /
Mensaje del Presidente                                                    Benchmarking:
2                                                                         A Comparison over Time
                                                                          35
IAMFA . . . The First Twenty Years
6                                                                         Reflections on Papyrus
                                                                          37
The Twentieth Annual IAMFA Conference
in San Francisco /                                                        Auckland Art Gallery Toi o TĀÆ
                                                                                                      amaki:
La Vingtième Conférence de l'IAMFA                                        Building Development Update
Ć  San Francisco /                                                         39
La VigƩsima Conferencia Anual de IAMFA
en San Francisco                                                          Regional Updates/Member News
15                                                                        42

2010 IAMFA Conference Schedule                                            IAMFA Members—Organizations

24                                                                        46
The National Gallery:                                                     Puzzle Page
Casting New Light on Old Masters                                          48
28
Cover photo: San Francisco's famous Golden Gate Bridge. Photo: Joe May

IAMFA BOARD OF DIRECTORS                                                   REGIONAL CHAPTERS
President                           Secretary and Papyrus Editor           Atlanta, U.S.A. — Kevin Streiter,      Ottawa-Gatineau, Canada —
John de Lucy                        Joseph E. May                          High Museum of Art                     Ian MacLean, Canada Science and

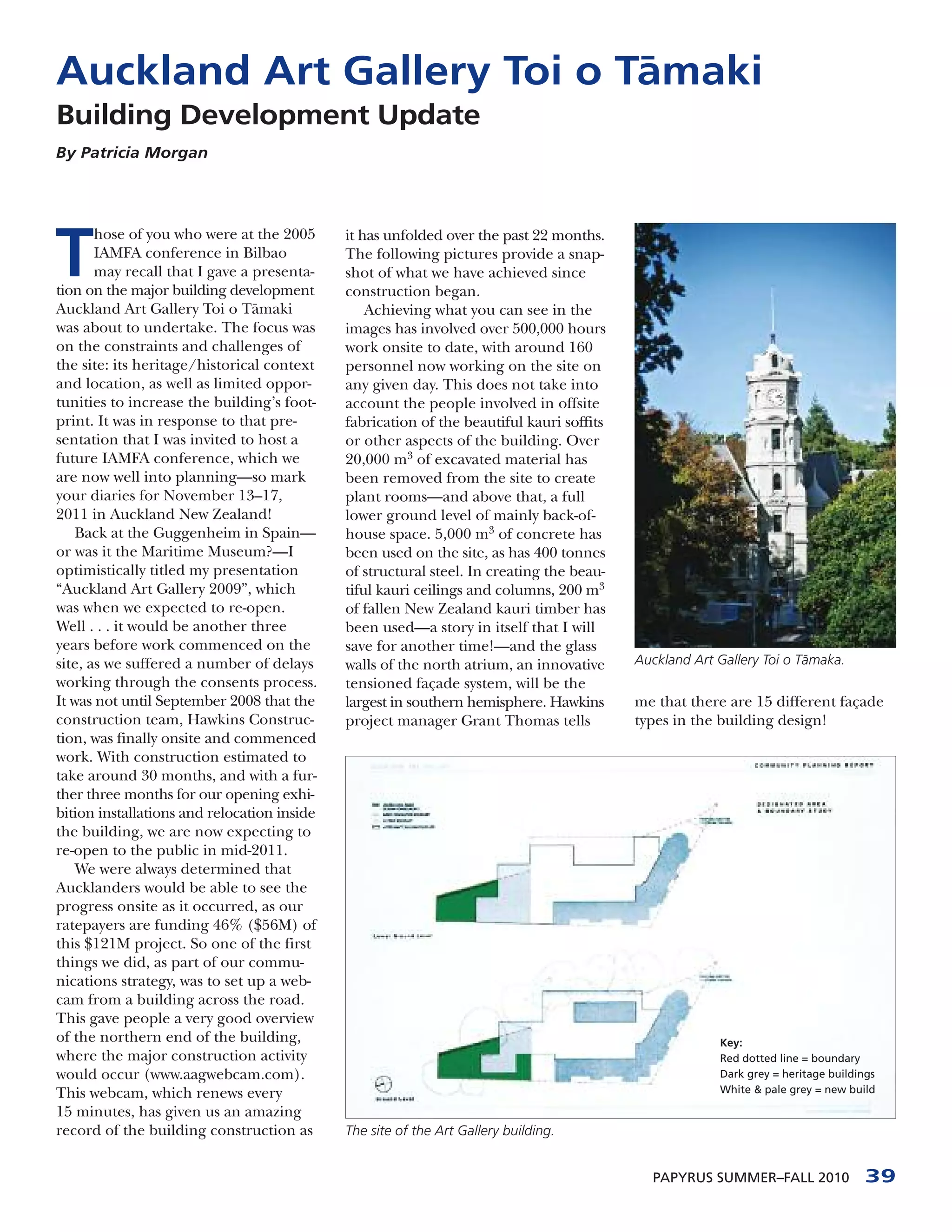

                                                                           kevin.streiter@woodruffcenter.org      Technology Museum Corporation
The British Library                 Sustainability Engineer                                                       imaclean@technomuses.ca
London, United Kingdom              Los Angeles, CA, USA                   Australia — Ray McMaster, Australian
john.delucy@bl.uk                   joemay001@hotmail.com                  National Maritime Museum               Philadelphia, USA — John Castle,

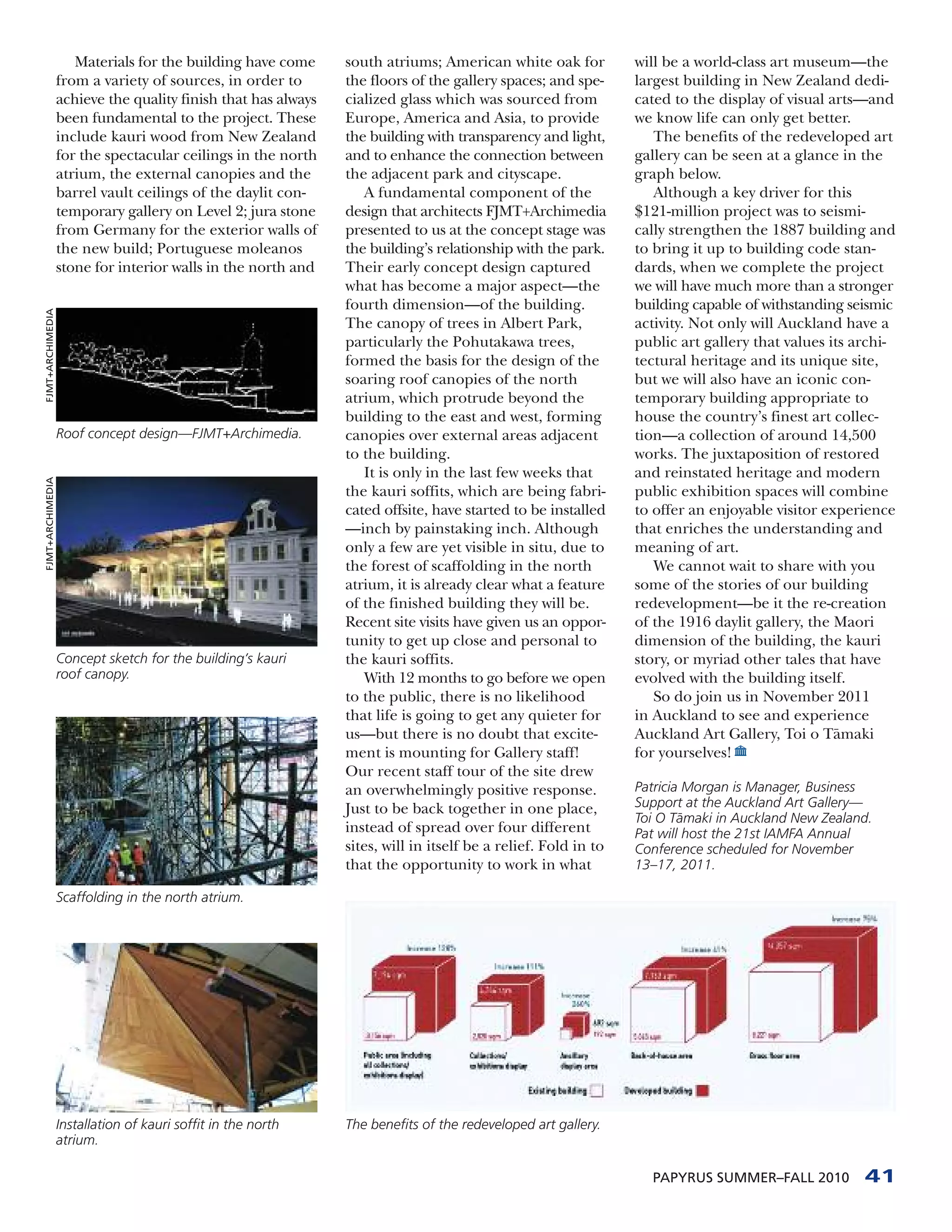

                                                                           rmcmaster@anmm.gov.au                  Winterthur Museum & Garden

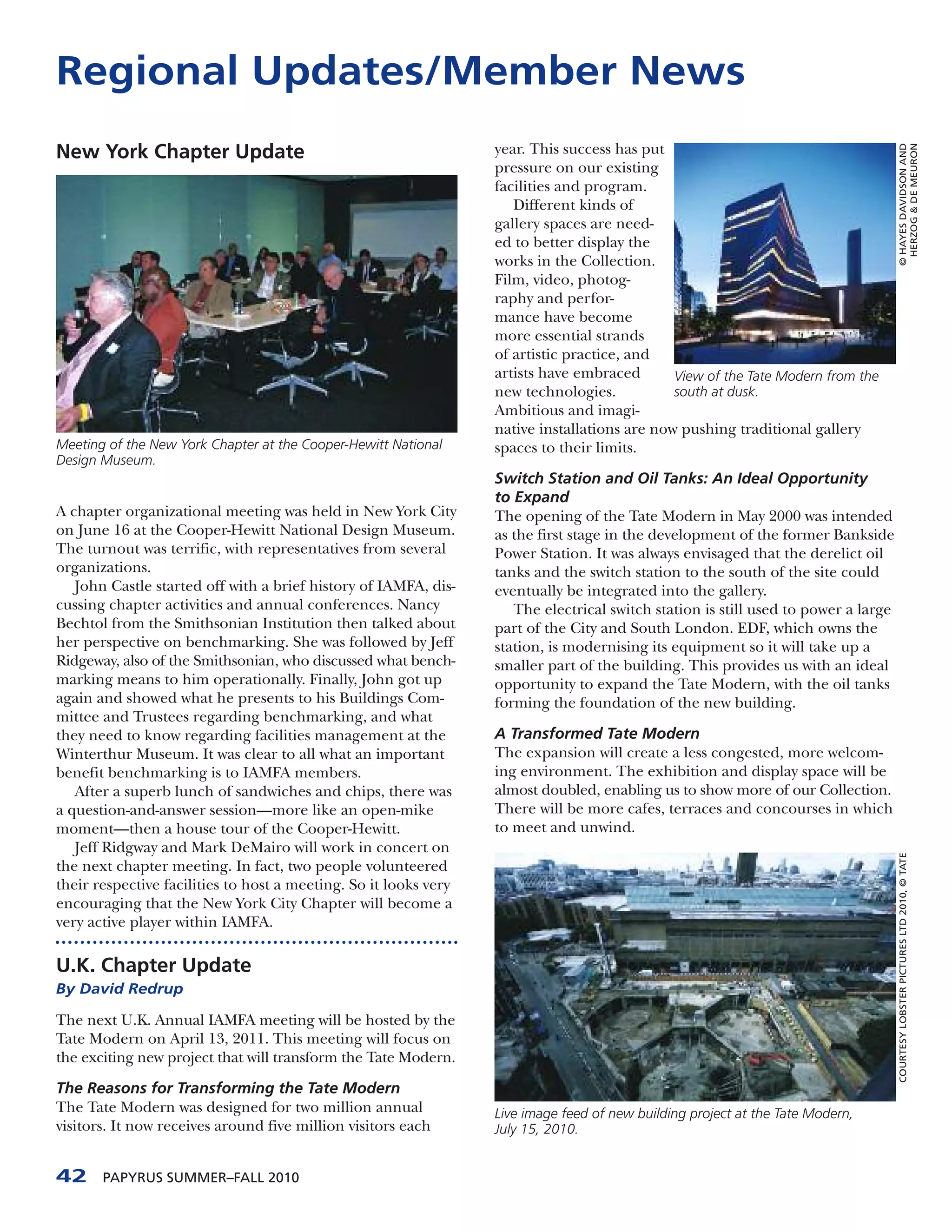

                                                                                                                  jcastle@winterthur.org
V.P., Administration                Chairman — Conference 2010             Bilbao, Spain — Rogelio Diez,
Alan Dirican                                                               Guggenheim Museum                      San Francisco, USA — Joe Brennan,
                                    Joe Brennan                            rdiez@guggenheim-bilbao.es             San Francisco Museum of Modern Art
Baltimore Museum of Art             San Francisco Museum of                                                       jbrennan@sfmoma.org
Baltimore, MD, USA                     Modern Art                          Chicago, USA — William Caddick,
adirican@artbma.org                                                        Art Institute of Chicago               United Kingdom — Jack Plumb,
                                    San Francisco, CA                      wcaddick@artic.edu                     National Library of Scotland
                                    jbrennan@sfmoma.org                                                           j.plumb@nls.uk
V.P., Regional Affairs                                                     Los Angeles, USA — Randy Murphy,
John Castle                                                                Los Angeles County Museum of Art       Washington/Baltimore, USA —
                                    Head of International Affairs          rmurphy@lacma.org                      Maurice Evans, Smithsonian
Winterthur Museum,
                                    Guy Larocque                                                                  Institution
Garden and Library                                                         New England, USA — John H.
                                    Canadian Museum of                                                            evansma@si.edu
Winterthur, DE, USA                                                        Lannon, Boston Athenaeum
                                      Civilization                         lannon@bostonathenaeum.org
jcastle@winterthur.org                                                                                                For more information on
                                    Gatineau, QC, Canada
                                                                           New York, USA — Mark Demairo,            becomming a member of the
Treasurer                           guy.larocque@civilization.ca           Neue Galerie                             International Association of
Larry Bannister                                                            markdemairo@neuegalerie.org
                                                                                                                   Museum Facility Administrators,
Milwaukee Public Museum             For additional contact information,    New Zealand — Patricia Morgan,                   please visit
Milwaukee, WI, USA                      please visit our website at        Auckland Art Gallery                           www.iamfa.org
bannister@mpm.edu                             www.iamfa.org                patricia.morgan@aucklandcity.govt.nz

IAMFA/ Papyrus                       Vincent Magorrian                    Editing                                 Statements of fact and opinion
Vol. 11, Number 2                    Joe May                              Artistic License (English)              are made on the responsibility of
Summer–Fall 2010                     Patricia Morgan                      Guy Laroque (French)                    authors alone and do not imply an
                                     Marla Neustadt                                                               opinion on the part of the editors,
                                                                          Printed in the U.S.A. by                officers, or members of IAMFA. The
Editor                               David Redrup
                                                                          Knight Printing                         editors of IAMFA Papyrus reserve the
Joe May                              Steve Vandyke                                                                right to accept or to reject any Article
                                     Thomas A. Westerkamp                                                         or advertisement submitted for
Papyrus Correspondents                                                    ISSN 1682-5241
                                                                                                                  publication.
John Castle                          Design and Layout
Daniel Davies                        Phredd Grafix                                                                While we have made every attempt to
Peter Fotheringham                                                                                                ensure that reproduction rights have
Guy Larocque                         Translation                                                                  been acquired for the illustrations
John de Lucy                         Marina Pascal (French)                                                       used in this newsletter, please let
                                                                                                                  us know if we have inadvertently
Maurice Evans                        Jeanne Pascal (Spanish)
                                                                                                                  overlooked your copyright, and
Pierre Lepage                                                                                                     we will rectify the matter in a
                                                                                                                  future issue.
Past issues of Papyrus can be found on IAMFA's website: www.IAMFA.org

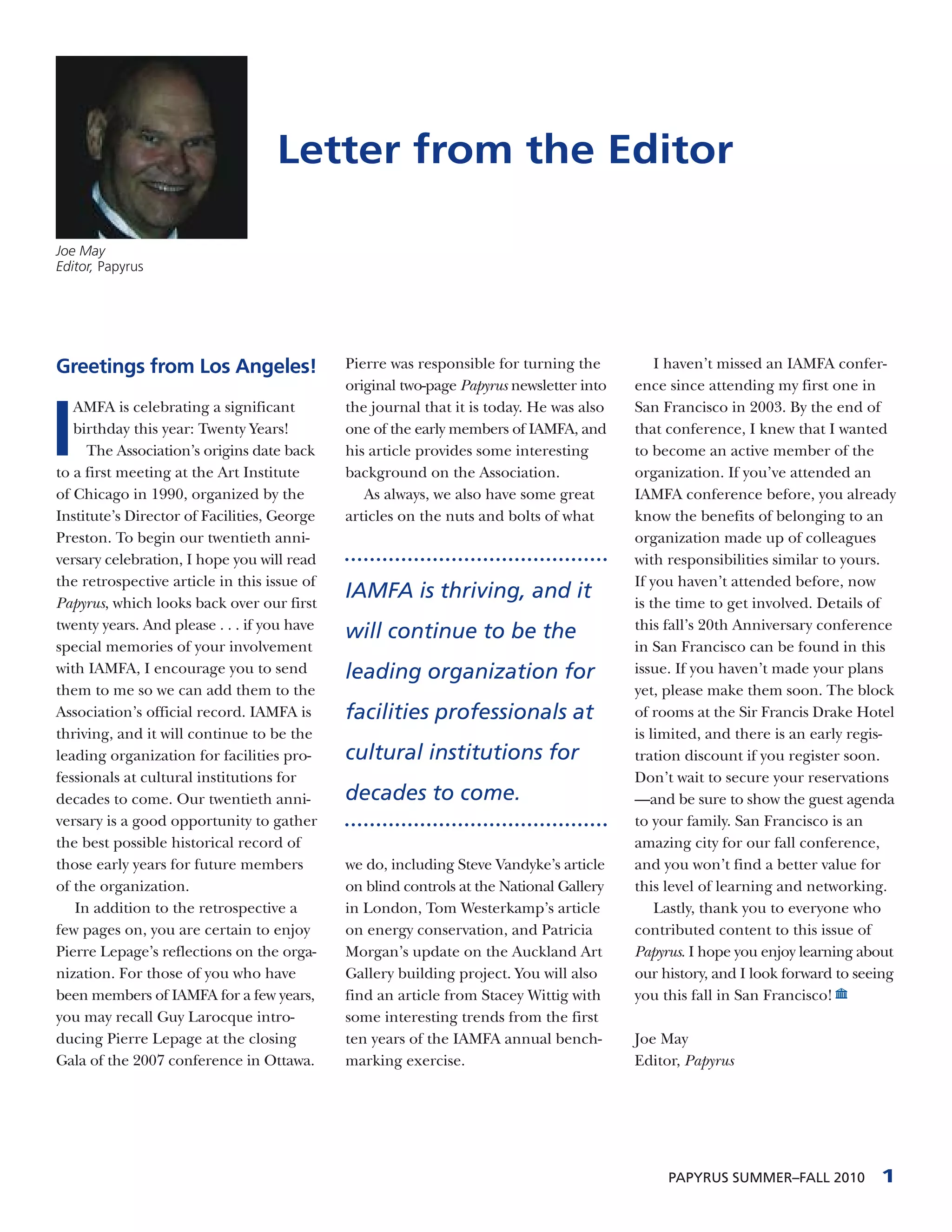

Letter from the Editor

Joe May
Editor, Papyrus

Greetings from Los Angeles!                  Pierre was responsible for turning the          I haven’t missed an IAMFA confer-
                                             original two-page Papyrus newsletter into   ence since attending my first one in

I
   AMFA is celebrating a significant         the journal that it is today. He was also   San Francisco in 2003. By the end of
   birthday this year: Twenty Years!         one of the early members of IAMFA, and      that conference, I knew that I wanted
     The Association’s origins date back     his article provides some interesting       to become an active member of the
to a first meeting at the Art Institute      background on the Association.              organization. If you’ve attended an
of Chicago in 1990, organized by the            As always, we also have some great       IAMFA conference before, you already
Institute’s Director of Facilities, George   articles on the nuts and bolts of what      know the benefits of belonging to an
Preston. To begin our twentieth anni-                                                    organization made up of colleagues
versary celebration, I hope you will read                                                with responsibilities similar to yours.
the retrospective article in this issue of                                               If you haven’t attended before, now
Papyrus, which looks back over our first
                                             IAMFA is thriving, and it                   is the time to get involved. Details of
twenty years. And please . . . if you have                                               this fall’s 20th Anniversary conference
                                             will continue to be the
special memories of your involvement                                                     in San Francisco can be found in this
with IAMFA, I encourage you to send          leading organization for                    issue. If you haven’t made your plans
them to me so we can add them to the                                                     yet, please make them soon. The block
Association’s official record. IAMFA is      facilities professionals at                 of rooms at the Sir Francis Drake Hotel
thriving, and it will continue to be the                                                 is limited, and there is an early regis-
leading organization for facilities pro-     cultural institutions for                   tration discount if you register soon.
fessionals at cultural institutions for                                                  Don’t wait to secure your reservations
decades to come. Our twentieth anni-         decades to come.                            —and be sure to show the guest agenda
versary is a good opportunity to gather                                                  to your family. San Francisco is an
the best possible historical record of                                                   amazing city for our fall conference,
those early years for future members         we do, including Steve Vandyke’s article    and you won’t find a better value for
of the organization.                         on blind controls at the National Gallery   this level of learning and networking.
   In addition to the retrospective a        in London, Tom Westerkamp’s article             Lastly, thank you to everyone who
few pages on, you are certain to enjoy       on energy conservation, and Patricia        contributed content to this issue of
Pierre Lepage’s reflections on the orga-     Morgan’s update on the Auckland Art         Papyrus. I hope you enjoy learning about
nization. For those of you who have          Gallery building project. You will also     our history, and I look forward to seeing
been members of IAMFA for a few years,       find an article from Stacey Wittig with     you this fall in San Francisco!
you may recall Guy Larocque intro-           some interesting trends from the first
ducing Pierre Lepage at the closing          ten years of the IAMFA annual bench-        Joe May
Gala of the 2007 conference in Ottawa.       marking exercise.                           Editor, Papyrus

                                                                                              PAPYRUS SUMMER–FALL 2010         1
Message from the President
                                      Message du prƩsident
                                      Mensaje del Presidente
John de Lucy
President / PrƩsident / Presidente,
IAMFA

San Francisco—                               San Francisco,                             Ā”San Francisco—
Here We Come!                                on y va!                                   Estamos en Camino!

T                                            L                                          E
       he U.K. Chapter has had such a             e chapitre du Royaume-Uni, j’ai             l CapĆ­tulo del Reino Unido ha
       successful year that, I understand,        entendu, a eu tellement de succès           experimentado tanto éxito este
       there will be 14 members plus              qu’il y aura 14 membres de plus             aƱo que tengo entendido que
guests attending from this side of the       parmi les invitƩs prƩsents de ce cƓtƩ      asistirƔn mƔs de 14 miembros de este
pond—an excellent turnout. Must be           de l’étang – un taux de participation      lado del charco a la conferencia—una
something in the air!                        excellent. Il doit y avoir quelque chose   representación excelente. ”Debe haber
   San Francisco in 2003 was my first        dans l’air!                                algo en el aire!
IAMFA conference, and Joe Brennan               San Francisco en 2003 a ƩtƩ ma pre-        La conferencia en San Francisco
and his team are putting together            miĆØre confĆ©rence de l’IAMFA et Joe         en 2003 fue mi primera conferencia
another fabulous treat for us all this       Brennan et son Ʃquipe sont en oeuvre       de IAMFA, y Joe Brennan y su equipo
fall. The one activity I particularly        pour nous faire une autre tournƩe fabu-    estƔn preparando otra fabulosa experi-
remember from 2003 was the California        leuse cet automne. L’activitĆ© dont je      encia para todos nosotros este otoƱo.
BBQ in an old dairy barn on the              me souviens particulièrement de 2003       La actividad de 2003 que mÔs me trae
Runnymede Sculpture Farm. I am               Ʃtait le barbecue Ơ la Californie Ơ une    recuerdos es la barbacoa de California
delighted that we are returning there        ancienne laiterie dans la Grange aux       que tuvo lugar en una vieja instalación
this year, so that you will be able to       sculptures Runnymede. Je suis ravi que     lechera de la Granja con esculturas
enjoy a similar event on Monday,             nous y retournions cette annƩe, de         Runnymede. Me complace saber que
October 18. This will be a unique            sorte que vous aussi pourriez profiter     vamos a regresar allƭ otra vez este aƱo
experience in a private park that you        d’un Ć©vĆ©nement similaire, le lundi         para que Ustedes tambiĆ©n puedan
cannot otherwise visit. Members and          18 octobre. Ce sera une expƩrience         disfrutar de un evento parecido, el
their guests will also have an oppor-        unique dans un parc privƩ que vous         lunes 18 de octubre. SerƔ una experi-
tunity to walk together across the           ne pouvez pas autrement visiter. Les       encia Ćŗnica en un parque privado que
Golden Gate Bridge on Wednesday              membres et leurs invitƩs auront Ʃgale-     normalmente es de acceso restringido.
afternoon, enjoying stunning views of        ment l’occasion de marcher ensemble        Los miembros y sus invitados tendrĆ”n
the city and Alcatraz. In the evening,       Ć  travers le Pont Golden Gate, mercredi    la oportunidad de caminar juntos a
we will attend the Gala dinner at the        aprĆØs-midi, profitant d’une vue impre-     travĆ©s del Puente Golden Gate en la
Maritime Museum with panoramic               nable sur la ville et sur Alcatraz. Dans   tarde del miƩrcoles, y disfrutar de unas
views of the bay at sunset.                  la soirƩe, nous allons assister au dƮner   vistas impresionantes de la ciudad y de
   Along with these unique events, the       de gala au MusƩe maritime avec une vue     Alcatraz. Por la tarde, asistiremos a la
programme is packed with behind-             panoramique sur la baie au coucher         comida de gala en el Museo MarĆ­timo
the-scenes tours, fabulous events and        du soleil.                                 con vistas panorƔmicas del ocaso en
educational visits, making this is a con-        Parallèlement à ces événements         la bahía.
ference that is not to be missed. If you     uniques, le programme est emballé             En conjunto con estos eventos úni-
haven’t looked at the proposed pro-          avec des visites dans-les-coulisses, de    cos, la agenda esta repleta de giras tras
gramme in detail, please do so in this       fabuleuses activitƩs et des visites Ʃdu-   bastidores, actividades fabulosas y visitas
issue of Papyrus, or online at www.iamfa.    catives, ce qui dĆ©montre qu’il s’agit      educacionales, demostrĆ”ndoles asĆ­ que
org/agenda2010—it is sure to entice          d’une confĆ©rence Ć  ne pas manquer.         no deben perderse esta conferencia. Si
members and, just as importantly,            Si vous n’avez pas regardĆ© le pro-         no se han fijado bien en el programa,
their guests.                                gramme proposĆ© dans le dĆ©tail, s’il        por favor mĆ­renlo en este ejemplar

2    PAPYRUS SUMMER–FALL 2010
Joe Brennan has chosen the dates        vous plaît faites-le dans ce numéro du      de Papyrus, o en la dirección en línea
to ensure fabulous weather and a full       Papyrus, ou en ligne Ć  www.iamfa.org/       www.iamfa.org/agenda2010—no cabe
moon (what, I wonder, is the signifi-       agenda2010 – on y est sĆ»r de capturer       duda que llamarĆ” la atención de los
cance of that!). I know he will have        l’attention des membres et, tout aussi      miembros y sus invitados, quienes son
something up his sleeve to surprise         important, de leurs invitƩs.                de igual importancia para nosotros.
us. At our April Board meeting, the             Joe Brennan a choisi les dates pour         Joe Brennan ha escogido las fechas
last activity on the agenda was a Sunday    assurer une mƩtƩo fabuleuse avec la         para que coincidan con la luna llena y
morning meeting at 5:00 a.m. to wit-        pleine lune (je me demande quelle est       asegurarnos un tiempo fabuloso (”me
ness an annual ceremony marking the         la signification de cela!). Je sais qu’il   pregunto cuĆ”l serĆ” el significado de
anniversary of the devastating 1906         aura quelque chose dans son sac pour        la luna llena!) Estoy seguro que estarĆ”
earthquake and fire. Joe May and I met      nous surprendre. En avril, lors de la       tramando algo especial para sorpren-
Joe Brennan in reception at 4:45 a.m.       rĆ©union du Conseil, la derniĆØre activitĆ©    dernos—en la reunión de la Junta
and walked to a firehouse close to the      sur l’ordre du jour a Ć©tĆ© une rĆ©union       Directiva de abril, la Ćŗltima actividad
hotel, where sirens sounded to mark         dimanche matin Ć  5h00 pour assister Ć        en el programa era una visita a las
the event (I pity the poor residents of     la cĆ©rĆ©monie annuelle marquant l’an-        5:00 a.m. a una ceremonia anual que
surrounding hotels). We then had to         niversaire de terribles tremblements        conmemora el aniversario del terre-
have a glass of port, and Joe Brennan       de terre et feu de 1906. Joe May et         moto e incendio devastadores de 1906.
gave us a keepsake of a black handker-      moi avons rencontrƩ Joe Brennan Ơ la        Joe May y yo nos reunimos con Joe
chief covered in red and orange flames.     réception à 4:45 am et nous sommes          Brennan en la recepción a las 4:45 a.m.
    This year’s conference hotel, the       allĆ©s vers une caserne de pompiers Ć         y caminamos hacia una estación de
Sir Francis Drake Hotel, already has        proximitĆ© de l’hĆ“tel où les sirĆØnes son-    bomberos cerca del hotel, donde sona-
firm bookings for 40 of the allocated       naient Ć  l’occasion des Ć©vĆ©nements (je      ron las sirenas para marcar el evento
50 rooms available at the reduced con-      suis dƩsolƩ pour les pauvres habitants      (lo lamento por los pobres ocupantes
ference rate. So, if you have not already   des hƓtels environnants). Ensuite, il       de los edificios cercanos). Luego nos
booked, make sure you register soon         a fallu que nous buvions un verre de        tomamos una copa de vino oporto, y
for one of the last 10 rooms!               porto et Joe Brennan nous a donné           Joe Brennan nos regaló como recuerdo
    Our American and Canadian col-          comme souvenir un mouchoir noir             un paƱuelo negro cubierto con un
leagues suffered badly last year with       couvert de flammes ardentes en rouge        diseƱo de llamas rojas y anaranjadas.
cutbacks, yet the very successful 2009      et orange.                                      El hotel de la conferencia de este
Washington conference had a record              L’hĆ“tel de la confĆ©rence de cette       aƱo, el Sir Francis Drake, ya tiene reser-
turnout, so let’s hope this year’s con-     annĆ©e, le Sir Francis Drake, a dĆ©jĆ          vaciones para 40 de los 50 cuartos
ference in San Francisco can be prior-      des rƩservations fermes pour 40 des         disponibles, a los precios reducidos
itized above any other conferences          50 chambres disponibles, allouƩes au        de la conferencia. Asƭ que si no han
you may be considering attending. If        taux réduit de conférence. Donc, si         reservado todavía, asegúrense de reg-
your boss is having trouble with the        vous n’avez pas dĆ©jĆ  en rĆ©servĆ©, assurez-   istrarse pronto para uno de los Ćŗltimos
word ā€œconferenceā€, assure him/her           vous de vous inscrire rapidement pour       10 cuartos!
that this is the best training session      l’un des 10 derniĆØres chambres!                 Nuestros colegas americanos y cana-
value of the year!                              Nos collègues américains et cana-       dienses han pasado por tiempos difíciles
    The last 18 months have focused         diens ont beaucoup souffert l’an            este Ćŗltimo aƱo debido a recortes de
our minds on matters financial—none         dernier en raison des compressions          presupuesto, sin embargo la asisten-
more so than those related to facilities    budgĆ©taires, mais l’édition trĆØs rĆ©ussie    cia a la muy exitosa conferencia de
management. Reducing costs and add-         de la Conférence de Washington 2009         Washington 2009 rompió record, así
ing value for money has been one way        a eu un taux de participation record;       que esperemos que al hacer la lista
in which facilities managers have proven    alors, espƩrons que celle de cette annƩe    de prioridades de este aƱo le den mƔs
their worth to organisations, particu-      à San Francisco puisse être priorisée       peso a la conferencia de San Francisco
larly in a time of economic crisis—         au dessus d’autres confĆ©rences que          que a todas las demĆ”s. Si a su super-
but is it a fair picture of all that you    vous envisagez assister. Si votre patron    visor le incomoda la palabra ā€œconfer-
as facility managers could achieve for      a des problĆØmes avec le mot Ā« confĆ©-        enciaā€, Ā”explĆ­quele que Ć©sta serĆ” la
your cultural organisations? There are      rence Ā», assurez-lui que c’est la plus      sesión de entrenamiento mĆ”s valiosa
opportunities ahead that we will need       prƩcieuse session de formation de           del aƱo!
to address in order to continue main-       l’annĆ©e!                                        Los eventos de los Ćŗltimos 18 meses
taining our vital role within our organi-       Les 18 derniers mois ont portƩ notre    han enfocado nuestras mentes en
sations. We need to take this changing      attention sur les questions financiĆØres,    asuntos financieros—sobre todo en
world into account, and realign our         mais plus encore sur celles liƩes Ơ la      el caso de los relacionados con mante-
roles and purpose if we wish to deliver     gestion des installations. RƩduire les      nimiento de instalaciones. Reducir
sustainable value to our organisations.     coƻts et maximiser le cƓut-bƩnƩfice         costos y maximizar costo-beneficio es
How are you going to improve your           a ƩtƩ une des faƧons dont les gestion-      una de las maneras en que los gerentes
game? Come to San Francisco and tell        naires d’installations ont pu dĆ©montrer     de mantenimiento han demostrado

                                                                                             PAPYRUS SUMMER–FALL 2010          3
us, or send Joe May an article for the       leur valeur aux organisations, en par-       su importancia a las organizaciones,
next edition of Papyrus.                     ticulier en temps de crise Ʃconomique        especialmente en los tiempos de crisis
   So, as the next generation of Facili-     – mais est-ce que c’est une image fidĆØle     económica—¿pero realmente es una
ties Managers, are you prepared to be        de tout ce que vous, en tant que ges-        imagen representativa de todo lo que
workplace enablers, become carbon-           tionnaires d’installations, pourriez         Ustedes como gerentes de mantenimi-
driven, link energy to maintenance, be       atteindre pour vos organisations cul-        ento pudieran lograr para sus organiza-
led by partnerships, invest in relations     turelles? Il y a des opportunitƩs Ơ venir    ciones culturales? Hay oportunidades
with suppliers, ensure that you become       auquelles nous devons faire face afin        en el futuro que nos veremos obligados
a Board Room item, be smart about            de maintenir notre rƓle vital au sein        a enfrentar para mantener nuestros
asset transfers, be intelligent about ser-   de nos organisations. Nous devons            papeles crĆ­ticos dentro de nuestras
vice delivery, and become integrated         prendre en compte ce monde en mu-            organizaciones. Necesitamos tomar en
with your colleagues in HR, Finance          tation et rƩaligner nos rƓles et nos         cuenta este mundo que estƔ en proceso
and IT? And that’s just for starters!        buts si nous voulons offrir une valeur       de cambio y rediseƱar nuestros papeles
                                             durable pour nos organisations. Com-         y objetivos si queremos seguir sumi-
                                             ment allez-vous amƩliorer votre jeu?         nistrando valor sostenible a nuestras
                                             Venez à San Francisco et dites-nous          organizaciones. ¿Cómo pueden mejorar
This conference will
                                             ou envoyez Ć  Joe May un article pour         sus estrategias de juego? Vengan a
provide an opportunity                       sa prochaine Ʃdition du Papyrus.             San Francisco y dƭgannos, o mƔndenle
                                                Donc, comme la prochaine généra-          un artículo a Joe May para su próxima
to exchange ideas and                        tion des gestionnaires d’installations,      edición de Papyrus.
                                             êtes-vous prêt à: dynamiser le milieu           Así que, como la próxima generación
develop a learning
                                             de travail, devenir un « conducteur-à-       de gerentes de mantenimiento, estÔn
partnership . . .                            carbon Ā», lier l’énergie vers l’entretien,   Ustedes preparados para: ser capaci-
                                             être guié par des partenariats, investir     tadores del lugar de trabajo, tomar
                                             dans les relations avec les fournisseurs,    decisiones en Āæbase del manejo de la
Cette confƩrence sera                        veiller Ơ ce que vous devenez un ƩlƩ-        huella de carbono? ligar la energƭa al
l’occasion d’échanger des                    ment discutĆ© par le Conseil, ĆŖtre Ć           mantenimiento, ser guiados por equipos
                                             puce sur les transferts d’actifs, ĆŖtre       de trabajo, invertir en relaciones con
idƩes et de dƩvelopper un                    intelligent sur la prestation des services   los proveedores, asegurar que sus metas
                                             et vous intégrer avec vos collègues des      formen parte de la agenda de la Junta
partenariat Ʃducatif . . .                   ressources humaines, des finances et         Directiva, saber llevar a cabo las trans-
                                             des TI? Et ce n’est qu’un dĆ©but!             ferencias de bienes con inteligencia,
Esta conferencia nos                            Au Royaume-Uni, le nouveau gou-           optimizar el plan de suministros, e
                                             vernement de coalition a annoncƩ une         integrarse con sus colegas de Recursos
brindarÔ la oportunidad                      réduction minimale prévue de 25 %            Humanos, Finanza, e InformÔtica? ”Y
                                             dans les budgets de toutes les institu-      todo esto es solamente el comienzo!
de intercambiar ideas y
                                             tions culturelles; nous sommes donc             En el Reino Unido, el nuevo
desarrollar un equipo                        confrontés à réfléchir sur la façon dont     gobierno de coalición ha anunciado
                                             nous offrons nos services avec une           que prevƩ un recorte del 25% mƭnimo
de aprendizaje . . .                         rƩduction importante des ressources          de todos los presupuestos de las insti-
                                             financiĆØres. Profitez de cette occasion      tuciones culturales, asĆ­ que nos vemos
                                             à la conférence pour aider vos cousins       forzados a enfocarnos en cómo pode-
    In the U.K., the new coalition gov-      du Royaume-Uni avec les expƩriences et       mos suministrar nuestros servicios con
ernment has announced an intended            les idées novatrices que vous avez trou-     una reducción realmente significativa
minimum 25% cut in the budgets of            vƩes! Voyons comment nos membres             de los recursos financieros. Aprove-
all cultural institutions, so we are faced   ont rƩussi Ơ maintenir les services dans     chen esta conferencia para ayudar a
with having to think hard about how we       un environnement de réduction sévère         sus primos del Reino Unido con las
deliver our services with a major reduc-     des coƻts.                                   experiencias e ideas innovadoras exi-
tion in financial resources. Do use this        Je crains que notre gouvernement          tosas que han descubierto! Discutamos
conference opportunity to help your          pourrait essayer de fusionner nos insti-     cómo nuestros miembros han logrado
U.K. cousins with the experiences and        tutions afin de rƩduire le nombre de         seguir suministrando servicios en
innovative ideas you have found that         musĆ©es individuels. Quelqu’un d’entre        un contexto de reducciones severas
work! Let’s discuss how our members          vous a eu cette expĆ©rience dans votre        de costos.
have managed to keep services going in       propre pays? Le ministĆØre britannique           Temo que nuestro gobierno intente
an environment of severe cost reduction.     de la Culture, des MƩdias et du Sport        unir a nuestras instituciones para redu-
    I am apprehensive that our govern-       a demandƩ des prƩcisions sur toutes          cir la cantidad de museos individuales.
ment might try to amalgamate our             les dates de la fin de nos contrats indi-    ĀæAlguno de Ustedes ha experimentado
CONTINUED ON PAGE 29                         SUITE ƀ LA PAGE 29                           SIGUE EN LA PƁGINA 29

4    PAPYRUS SUMMER–FALL 2010
IAMFA . . .
The First Twenty Years

2
       010 marks the twentieth anni-               attend the meeting, but had no idea           Washington, D.C. —1991
       versary of IAMFA, and our                   what to expect. At the time, Vinny was        Greg Reynolds was in charge of mak-
       San Francisco conference host               a member of the Building Owners and           ing preparations for this inaugural
Joe Brennan thought it fitting that we             Managers Association (BOMA) and               IAMFA conference, with help from
publish an article about the Associa-              remembers that, while BOMA did                colleagues at other local museums.
tion’s history. Many of us have been               provide the means to keep abreast of          What was obvious at this first IAMFA
members of IAMFA for years, but I                  changes in technology, it was geared          conference was that the early members
think most would agree that we really              more toward commercial buildings. This        were very eager to share their ideas.
don’t know exactly how IAMFA came                  left him feeling that he needed more.         Included were educational sessions
into existence. Fortunately, there are             The host of the meeting in Chicago
still active members who were present              was George Preston, who was Facilities
during those initial years, and they have          Director at the Art Institute. He was a
helped us document IAMFA’s history.                large man—not just physically, but intel-
One of these individuals is Vincent                lectually—and he was very determined.
Magorrian, who is the retired Facilities           George believed that this group could
Director for the Museum of Modern                  organize and become the first true
Art in New York City. Vinny is a charter           museum facilities organization. All
member of IAMFA, and also served as                of the individuals in attendance intro-
President of IAMFA during the Asso-                duced themselves, and spoke about
ciation’s early years. Please read on to           their own institutions, then collectively
learn more about IAMFA’s history.                  spent a lot of time brainstorming about
                                                   what kind of organization they could
                                                   be. Above all, George wanted to charter
Chicago —1990                                      the organization, and he wanted bylaws
In 1990, Vinny Magorrian received                  like APPA (the Association of Physical
an invitation from the Art Institute               Plant Administrators). From the first
of Chicago to attend a meeting in                  day, George worked to establish bylaws;
Chicago, along with representatives                and if George wanted to accomplish            The National Gallery of Art in Washington,
from other museums. He decided to                  something, he did.                            D.C.

The Art Institute of Chicago. The individuals at this first meeting in
Chicago decided that their next meeting would be in Washington,           From an early IAMFA meeting. Front left: Vinny Magorrian; right:
D.C., and in the year leading up to that meeting, IAMFA was               Ron Puska; back centre: Myro Resnick. The two others are
incorporated as a not-for-profit organization.                            unknown.

6    PAPYRUS SUMMER–FALL 2010

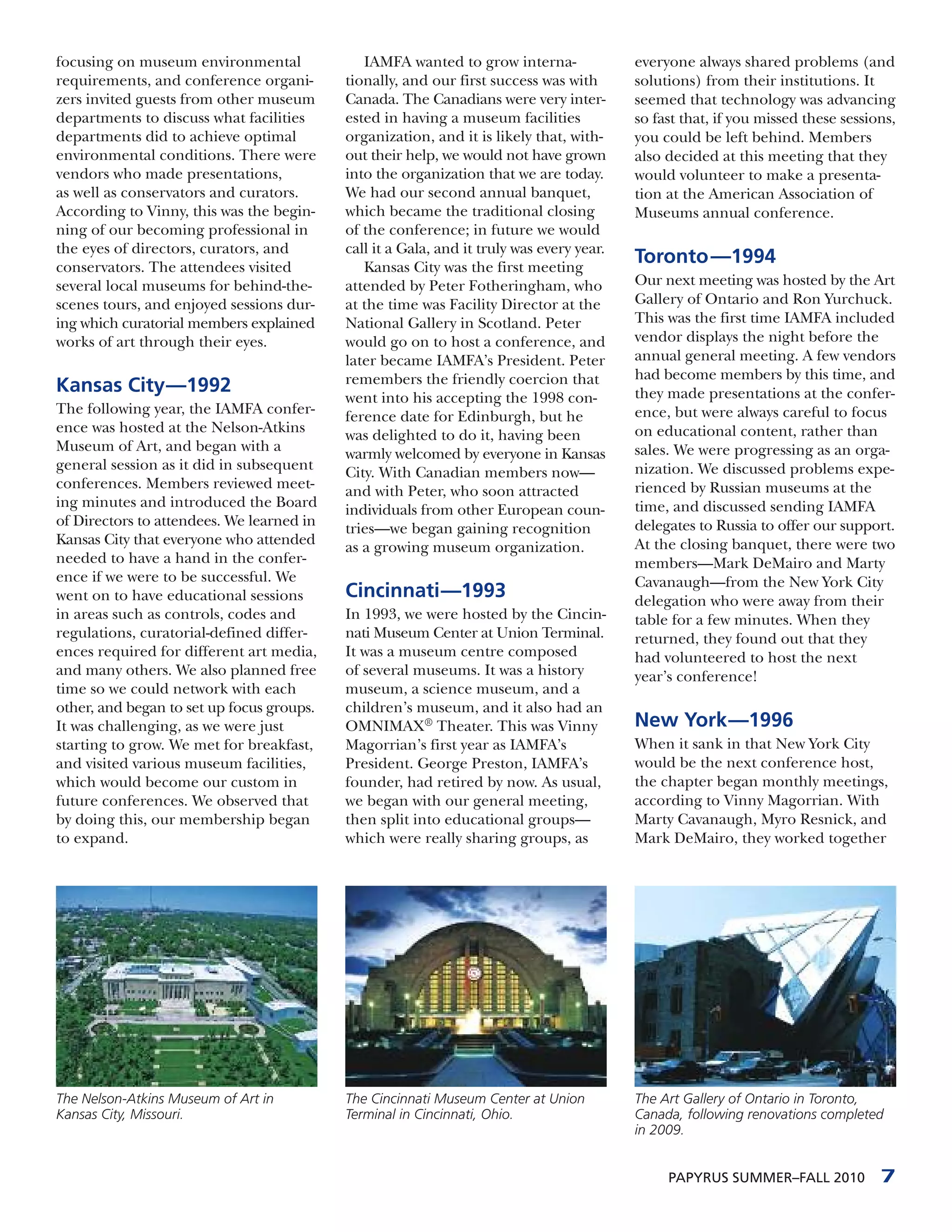

focusing on museum environmental              IAMFA wanted to grow interna-               everyone always shared problems (and
requirements, and conference organi-       tionally, and our first success was with       solutions) from their institutions. It
zers invited guests from other museum      Canada. The Canadians were very inter-         seemed that technology was advancing
departments to discuss what facilities     ested in having a museum facilities            so fast that, if you missed these sessions,
departments did to achieve optimal         organization, and it is likely that, with-     you could be left behind. Members
environmental conditions. There were       out their help, we would not have grown        also decided at this meeting that they
vendors who made presentations,            into the organization that we are today.       would volunteer to make a presenta-
as well as conservators and curators.      We had our second annual banquet,              tion at the American Association of
According to Vinny, this was the begin-    which became the traditional closing           Museums annual conference.
ning of our becoming professional in       of the conference; in future we would
the eyes of directors, curators, and       call it a Gala, and it truly was every year.
conservators. The attendees visited           Kansas City was the first meeting
                                                                                          Toronto —1994
several local museums for behind-the-      attended by Peter Fotheringham, who            Our next meeting was hosted by the Art
scenes tours, and enjoyed sessions dur-    at the time was Facility Director at the       Gallery of Ontario and Ron Yurchuck.
ing which curatorial members explained     National Gallery in Scotland. Peter            This was the first time IAMFA included
works of art through their eyes.           would go on to host a conference, and          vendor displays the night before the
                                           later became IAMFA’s President. Peter          annual general meeting. A few vendors
                                           remembers the friendly coercion that           had become members by this time, and
Kansas City—1992                                                                          they made presentations at the confer-
                                           went into his accepting the 1998 con-
The following year, the IAMFA confer-                                                     ence, but were always careful to focus
                                           ference date for Edinburgh, but he
ence was hosted at the Nelson-Atkins                                                      on educational content, rather than
                                           was delighted to do it, having been
Museum of Art, and began with a                                                           sales. We were progressing as an orga-
                                           warmly welcomed by everyone in Kansas
general session as it did in subsequent                                                   nization. We discussed problems expe-
                                           City. With Canadian members now—
conferences. Members reviewed meet-                                                       rienced by Russian museums at the
                                           and with Peter, who soon attracted
ing minutes and introduced the Board                                                      time, and discussed sending IAMFA
                                           individuals from other European coun-
of Directors to attendees. We learned in                                                  delegates to Russia to offer our support.
                                           tries—we began gaining recognition
Kansas City that everyone who attended                                                    At the closing banquet, there were two
                                           as a growing museum organization.
needed to have a hand in the confer-                                                      members—Mark DeMairo and Marty
ence if we were to be successful. We                                                      Cavanaugh—from the New York City
went on to have educational sessions       Cincinnati—1993                                delegation who were away from their
in areas such as controls, codes and       In 1993, we were hosted by the Cincin-         table for a few minutes. When they
regulations, curatorial-defined differ-    nati Museum Center at Union Terminal.          returned, they found out that they
ences required for different art media,    It was a museum centre composed                had volunteered to host the next
and many others. We also planned free      of several museums. It was a history           year’s conference!
time so we could network with each         museum, a science museum, and a
other, and began to set up focus groups.   children’s museum, and it also had an
It was challenging, as we were just        OMNIMAXĀ® Theater. This was Vinny               New York—1996
starting to grow. We met for breakfast,    Magorrian’s first year as IAMFA’s              When it sank in that New York City
and visited various museum facilities,     President. George Preston, IAMFA’s             would be the next conference host,
which would become our custom in           founder, had retired by now. As usual,         the chapter began monthly meetings,
future conferences. We observed that       we began with our general meeting,             according to Vinny Magorrian. With
by doing this, our membership began        then split into educational groups—            Marty Cavanaugh, Myro Resnick, and
to expand.                                 which were really sharing groups, as           Mark DeMairo, they worked together

The Nelson-Atkins Museum of Art in         The Cincinnati Museum Center at Union          The Art Gallery of Ontario in Toronto,
Kansas City, Missouri.                     Terminal in Cincinnati, Ohio.                  Canada, following renovations completed
                                                                                          in 2009.

                                                                                               PAPYRUS SUMMER–FALL 2010           7
to develop a program, and began to           did that thinking it would give them        we visited too, but the Getty Center
schedule speakers and solicit support        the true feeling of an opening.             was overwhelming in its grandeur.
from member facilities. The banquet              The highlight for many during the       This was the first year awards were
was to be held at the Guggenheim,            April 1996 conference was a boat trip       presented at the Gala; and the first
and our meeting would be at Doral            to Ellis Island. It was amazing to walk     presented was the George Preston
Hotel in Manhattan, with visits to           the halls where so many came to the         Memorial Award. It was presented to
various museums.                             United States. But it was also eerie as     Ron Puska, who had served in several
   Peter Fotheringham made a pre-            members went to areas not open to           capacities within IAMFA, and who was
sentation about emergency prepared-          the public, such as hospital rooms with     always willing to offer his time to the
ness, in which he related events at the      a single light bulb, and crumbling walls.   organization. Vinny Magorrian was
National Gallery and an attack with          According to Vinny, you could feel the      proud to receive ā€œThe Member of the
explosives by the IRA, as well as collec-    hurt of those who were sent back to         Year Awardā€, which Vinny thinks Mark
tion storage practices in salt mines dur-    their original countries because of         DeMairo had something to do with.
ing the Second World War. There was          illness; the most common cause being        Maybe the time will come soon to
a major opening of Matisse’s work at         pink eye, which is so easily treated        resurrect the George Preston Award?
the Museum of Modern Art (MOMA),             now. Vinny remembers feeling many           Without George, there would be no
and Vinny got tickets for attendees;         emotions while visiting those areas         IAMFA. George was a mentor, and a
however, he reports that he is still in      where families were broken up, and felt     driving force in establishing IAMFA,
trouble with his wife and others for         he was changed from then on. The            and he always pushed the officers to
having them wait in line, and says he        team shared a sense of pride for the        make IAMFA better.
                                             success of the New York conference.
                                                                                         Edinburgh, Scotland —1998
                                             Los Angeles—1997                            Our next IAMFA annual conference
                                             Our next conference was held at the         was held in Edinburgh, and was hosted
                                             Getty Center, which was still under         by Robert Galbraith, with help from
                                             construction in Los Angeles at the          Peter Fotheringham. Peter had agreed
                                             time. It was a beautiful site, and mas-     to host the 1998 conference while in
                                             sive, and knowing that there was not        Kansas City, but moved to the National
                                             really a budget made us all envious.        Gallery in London in 1994, leaving
                                             The host was Lloyd Randolph. We             Robert with the responsibility! The con-
                                             also visited the Old Getty Museum in        ference in Edinburgh was a big step
                                             Malibu, and celebrated Cinco de             for IAMFA, as we now had a presence
                                             Mayo at the Museum of Contempo-             in Europe. In the year leading up to
                                             rary Art. There were other museums          the May 10–13, 1998 conference in

The Museum of Modern Art in New York City.

The Guggenheim Museum in New York City.      The new Getty Center in Los Angeles.

8    PAPYRUS SUMMER–FALL 2010

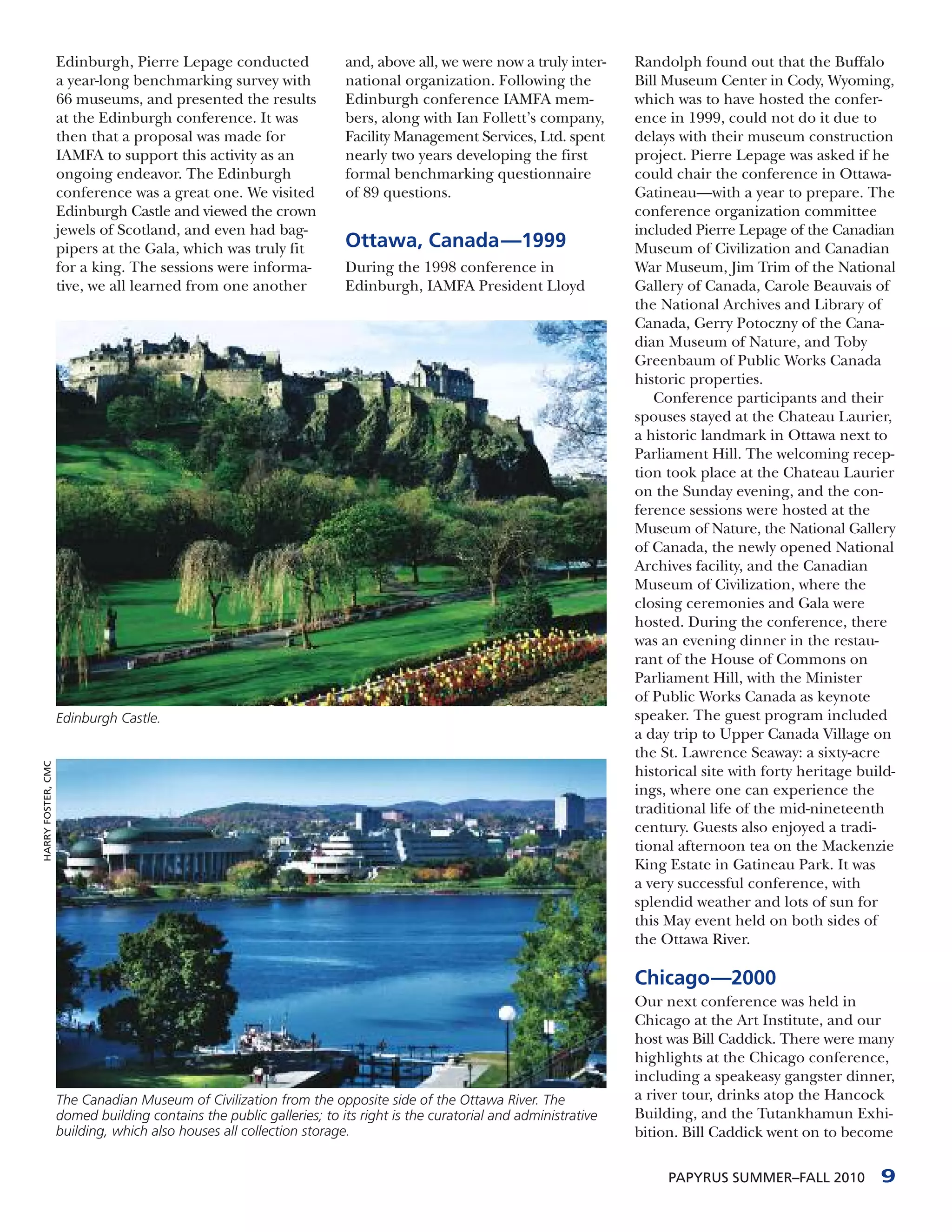

Edinburgh, Pierre Lepage conducted                and, above all, we were now a truly inter-      Randolph found out that the Buffalo
                    a year-long benchmarking survey with              national organization. Following the            Bill Museum Center in Cody, Wyoming,
                    66 museums, and presented the results             Edinburgh conference IAMFA mem-                 which was to have hosted the confer-
                    at the Edinburgh conference. It was               bers, along with Ian Follett’s company,         ence in 1999, could not do it due to
                    then that a proposal was made for                 Facility Management Services, Ltd. spent        delays with their museum construction
                    IAMFA to support this activity as an              nearly two years developing the first           project. Pierre Lepage was asked if he
                    ongoing endeavor. The Edinburgh                   formal benchmarking questionnaire               could chair the conference in Ottawa-
                    conference was a great one. We visited            of 89 questions.                                Gatineau—with a year to prepare. The
                    Edinburgh Castle and viewed the crown                                                             conference organization committee
                    jewels of Scotland, and even had bag-                                                             included Pierre Lepage of the Canadian
                    pipers at the Gala, which was truly fit           Ottawa, Canada—1999                             Museum of Civilization and Canadian
                    for a king. The sessions were informa-            During the 1998 conference in                   War Museum, Jim Trim of the National
                    tive, we all learned from one another             Edinburgh, IAMFA President Lloyd                Gallery of Canada, Carole Beauvais of
                                                                                                                      the National Archives and Library of
                                                                                                                      Canada, Gerry Potoczny of the Cana-
                                                                                                                      dian Museum of Nature, and Toby
                                                                                                                      Greenbaum of Public Works Canada
                                                                                                                      historic properties.
                                                                                                                         Conference participants and their
                                                                                                                      spouses stayed at the Chateau Laurier,
                                                                                                                      a historic landmark in Ottawa next to
                                                                                                                      Parliament Hill. The welcoming recep-
                                                                                                                      tion took place at the Chateau Laurier
                                                                                                                      on the Sunday evening, and the con-
                                                                                                                      ference sessions were hosted at the
                                                                                                                      Museum of Nature, the National Gallery
                                                                                                                      of Canada, the newly opened National
                                                                                                                      Archives facility, and the Canadian
                                                                                                                      Museum of Civilization, where the
                                                                                                                      closing ceremonies and Gala were
                                                                                                                      hosted. During the conference, there
                                                                                                                      was an evening dinner in the restau-
                                                                                                                      rant of the House of Commons on
                                                                                                                      Parliament Hill, with the Minister
                                                                                                                      of Public Works Canada as keynote
                    Edinburgh Castle.                                                                                 speaker. The guest program included
                                                                                                                      a day trip to Upper Canada Village on
                                                                                                                      the St. Lawrence Seaway: a sixty-acre
HARRY FOSTER, CMC

                                                                                                                      historical site with forty heritage build-
                                                                                                                      ings, where one can experience the
                                                                                                                      traditional life of the mid-nineteenth
                                                                                                                      century. Guests also enjoyed a tradi-
                                                                                                                      tional afternoon tea on the Mackenzie
                                                                                                                      King Estate in Gatineau Park. It was
                                                                                                                      a very successful conference, with
                                                                                                                      splendid weather and lots of sun for
                                                                                                                      this May event held on both sides of
                                                                                                                      the Ottawa River.

                                                                                                                      Chicago—2000
                                                                                                                      Our next conference was held in
                                                                                                                      Chicago at the Art Institute, and our
                                                                                                                      host was Bill Caddick. There were many
                                                                                                                      highlights at the Chicago conference,
                                                                                                                      including a speakeasy gangster dinner,
                    The Canadian Museum of Civilization from the opposite side of the Ottawa River. The               a river tour, drinks atop the Hancock
                    domed building contains the public galleries; to its right is the curatorial and administrative   Building, and the Tutankhamun Exhi-
                    building, which also houses all collection storage.                                               bition. Bill Caddick went on to become

                                                                                                                           PAPYRUS SUMMER–FALL 2010          9
United Kingdom
                                                   Washington, D.C./Baltimore

                                               Washington, D.C.—2001
                                               The Washington, D.C. conference was
                                               originally scheduled for September
                                               2001, but was cancelled due to 9/11.
                                               The Committee, led by Fletcher
                                               Johnston and coordinated by Marla
                                               Chanin Tobar (now Marla Neustadt),
The Field Museum: one of the featured sites    faced a challenge: reorganize and           The Natural History Museum in Washington,
of the 2000 IAMFA annual conference.           reschedule all the arrangements, or         D.C. during the 2001 IAMFA conference.
                                               let the D.C. conference slip away. The
IAMFA’s President in 2002. Regional            choice was to pull ourselves up by the
                                                                                           the first benchmarking exercise were
chapters were formally established at the      bootstraps—as many others did in the
                                                                                           presented to participating members on
IAMFA annual conference in Chicago             wake of 9/11—and put together another
                                                                                           Sunday, December 2, 2001. Today, this
in September 2000.                             amazing program for December 2–5.
                                                                                           valuable exercise is in its tenth year.
   Over the years, regional chapters           An Indian summer welcomed members
were founded in metropolitan areas to          to tours, the benchmarking workshop,
                                               educational sessions, and festivities at    London—2002
give local members an opportunity to
meet on their own, both to learn from          the Smithsonian, Meridian International     Peter Fotheringham was the organizer
one another and to network. Regional           Center, and the Holocaust Museum,           of the 2002 London conference. This
chapters have become effective forums          among others, and an infamous clos-         was Peter’s final year as President of
for the exchange of information among          ing Gala at the National Gallery of Art.    IAMFA, and Bill Caddick from the
local members, while also attracting           IAMFA’s members showed their resi-          Art Institute of Chicago was elected
non-members and encouraging them               lience and spirit by absorbing the impact   new President during the conference.
to join our organization. Today, IAMFA         of 9/11 and rallying to attend the D.C.     The program spanned three days,
has 13 local chapters, located in:             conference in December. The results of      and included the National Gallery, the
                                                                                           British Museum, and the British Library.
   Atlanta                                                                                 Pierre Lepage recalls the meeting as
   Australia                                                                               being a very informative one and,
   Bilbao, Spain                                                                           among other things, remembers the
   Chicago                                                                                 stunning new geodesic dome over the
   Los Angeles                                                                             British Museum’s inner court and
   New England                                                                             library, as well as a presentation on
   New York City                                                                           operations and maintenance at the
   New Zealand                                                                             British Library’s new St. Pancras com-
   Ottawa-Gatineau, Canada                                                                 plex. We visited the newly opened Tate
   Philadelphia                                Recent meeting of the Washington,           Modern Gallery, and learned about
   San Francisco                               D.C./Baltimore Chapter.                     lighting and natural light control at

Recent meeting of the U.K. Chapter in Liverpool.                      Philadelphia Chapter members meeting at the Winterthur Museum
                                                                      and Country Estate in nearby Delaware.

10     PAPYRUS SUMMER–FALL 2010
Boston—2004
                                            The 2004 conference was held in
                                            Boston, Massachusetts. Jim Moisson
                                            led this incredible effort. A hotel room
                                            had been booked for vendors to display
                                            their products and services. We toured
                                            Boston Harbor by boat, and visited the
                                            Isabella Stewart Gardner Museum—
                                            known as the site of the biggest art
                                            theft in history. Shortly after midnight
The British Library during the 2002 IAMFA   on the morning of March 18, 1990,          The Fogg Museum of Art at Harvard
conference in London.                       thieves disguised as police officers       University in Boston, Massachusetts.
                                            talked their way into the Museum.
                                            They handcuffed the two security
the National Gallery. A highlight for       guards on duty and stowed them             sentations from the architects and
many was the bus trip to the conference     out of sight, then stole 13 works of       engineers responsible for design and
dinner in a Routemaster Bus: the            art valued at over $500 million. The       construction of the Guggenheim, itself
traditional London doubledecker.            crime still remains unsolved.              a fabulous work of art. In addition to
                                               We visited the Boston Athenaeum,        our annual general meeting, we also
                                                                                       had a brainstorming session aimed at
San Francisco—2003                          had lunch at the Union Club, then
                                            walked across Boston Common. We            shaping future strategy for IAMFA, and
The conference in San Francisco was                                                    we will do this again in San Francisco
Joe May’s first, and he says he knew        learned about LED lighting at this
                                            conference, and at the 2010 confer-        this fall at the 2010 IAMFA conference.
by the end of the conference that he                                                   We visited the Maritime Museum, the
wanted to become an active member           ence in San Francisco, LSI Lighting
                                            will once again make a presentation        Fine Arts Museum and Old Town, and
of IAMFA. There was a presentation                                                     we heard from Pat Morgan on plans
on security requirements in the post-       on new developments in LED lighting.
                                            We visited the Museum of Fine Arts,        for the redevelopment project at the
9/11 era, and on base isolation as a                                                   Auckland Art Gallery Toi o TĀÆ maki
                                                                                                                      a
means of protecting buildings in seis-      and the Peabody Essex Museum. Guy
                                            Larocque was elected the next IAMFA        in New Zealand. We’ll see this project
mically active areas. We visited the                                                   firsthand in the fall of 2011 when
deYoung Museum—then still under             President in Boston, and he went on to
                                            become our longest-serving President.      New Zealand hosts the 21st IAMFA
construction—to see a base isolation                                                   conference, and you can read more
system being installed, and we will be      One big question from the Boston con-
                                            ference was whether the lobster boil       about recent developments in this
visiting the deYoung again during the                                                  issue of Papyrus. We headed into the
2010 IAMFA conference. We visited           in the countryside was the highlight
                                            of the conference, or whether it was       Spanish countryside for dinner, and
the Cable Car Museum, had lunch at                                                     heard about the Getty Center’s recent
Fisherman’s Wharf, and travelled by         the Fogg Museum of Art at Harvard
                                            University for the Gala. Both were         LEED-EB Certification, as well as the
boat to Alcatraz Island. We visited the                                                British Library’s plans to build a low-
Aquarium in its last months, prior to       amazing!
                                                                                       oxygen storage facility near York. His-
the site being cleared for construction                                                tory has shown that we’ve often had
of the New California Academy of            Bilbao, Spain—2005                         opportunities to visit places we’ve
Sciences. We visited SFMOMA and             IAMFA’s 2005 annual conference was         heard about in IAMFA conference
other institutions in San Francisco.        held in Bilbao, Spain. We heard pre-       presentations.
Joe also remembers that the Legion
of Honor, where the conference Gala
was held, was the most elegant setting
he had ever seen.

The Legion of Honor, site of the closing
Gala for the 2003 conference in
San Francisco.                              The Guggenheim Museum in Bilbao, Spain.

                                                                                          PAPYRUS SUMMER–FALL 2010            11
Los Angeles—2006                            the Canada Aviation Museum, and                British Museum, the National Gallery,
In 2006, the conference was held            the Canadian War Museum. We had                the British Library, the Maritime
in Los Angeles at the Getty Villa and       dinner one evening at the l’OrĆ©e du            Museum and Royal Observatory and
Center, the LA County Museum of             bois Restaurant in the countryside. We         the Natural History Museum. The
Art (LACMA), the Museum of Con-             stayed next door to Parliament Hill at         conference reception was held in the
temporary Art (MOCA), the Disney            the Chateau Laurier Hotel. We learned          King’s Library at the British Museum
Concert Hall, the Petersen Auto-            about fire-suppression systems, micro-         and, following the opening program,
motive Museum, and the Japanese             climate displays, preparing for redevel-       we wandered through the dimly lit
American Art Museum. Guests also            opment programs, maintenance issues            galleries to see such exhibits as the
visited Universal Studios and the           today and tomorrow, and the Library of         Rosetta Stone and the Elgin Marbles.
Reagan Presidential Library. We heard       Congress’s new Audio Visual Center,            It was a great kick-off to a memorable
presentations on the renovation pro-        which we would have the opportunity            conference. We attended presentations
ject at the Getty Villa (the predecessor    to visit in 2009. The conference closed        focusing on several themes, including
of the Getty Center), building com-         with a very elegant Gala Dinner at the         energy savings and performance audits,
missioning, fire-protection strategies,     Canadian Museum of Civilization.               facilities management and contracts,
and an FBI agent discussed art theft           During 2007, we also saw Papyrus            capital projects, and climate change.
issues that museums face. We heard          printed in full color for the first time.      This year, the conference was extended
presentations on LACMA’s construc-                                                         an optional fourth day, and members
tion program, and the Smithsonian’s         London—2008                                    and guests traveled by rail to York to
new asset management system, and            In 2008, we met in London for the              visit the new British Library low-oxygen
cruised Marina Del Rey for dinner,          IAMFA conference hosted by the                 storage facility. We also traveled down
complete with a rumored marriage
proposal at dinner (sorry, no update
available). We toured MOCA and the
Disney Concert Hall, which is another
Frank Gehry design (as was the Guggen-
heim in Bilbao). Facility Issues Inc.,
led by Keith McClanahan, took over
this year as facilitator of the museum
benchmarking exercise.

Ottawa-Gatineau,
Canada—2007
In 2007 we met in Ottawa-Gatineau,
where we visited the National Gallery,
the Canadian Museum of Civilization,
the Library Archives Canada Gatineau
Preservation Centre, the Canada             The closing Gala of the 2008 IAMFA conference in London, held in the Earth Gallery at the
Science and Technology Museum,              Natural History Museum.

Members and guests at the Getty Center during the 2006 IAMFA        Members and guests on the plaza at the Canadian Museum of
conference.                                                         Civilization during the 2007 IAMFA conference.

12     PAPYRUS SUMMER–FALL 2010
the Thames by boat to Greenwich,               We visited war memorials and monu-            the United States. This year the confer-
where we walked the Meridian Line              ments at night under a full moon. This        ence was extended an optional fourth
and attended a presentation in the             year, guests visited Baltimore while mem-     day again, with a visit to the new Library
Peter Harrison Planetarium. Refresh-           bers attended the Sunday benchmarking         of Congress National Audiovisual Con-
ments afterward were at the Trafalgar          workshop at the Baltimore Museum              servation Center in Virginia. Follow-
Pub, a well-known institution where            of Art, hosted by Alan Dirican. During        ing lunch at a winery, we visited the
we all enjoyed a pint or two. Confer-          their visit, guests were given guided         Smithsonian Institution’s Air and
ence guests had a very busy agenda,            tours by BMA Director Doreen Bolger           Space Museum near Dulles Airport.
including a visit to the Tower of              of the exhibitions Edgar Allan Poe: A            During 2009, Papyrus was given
London, a private meeting with the             Baltimore Icon and Matisse as Printmaker.     another facelift, becoming more like a
Queen’s Jeweller, a viewing of the crown       They also visited the Baltimore Aquar-        magazine, and members increasingly
jewels, a visit to Kensington Palace—          ium. The opening ceremony was held            contributed content.
and with numerous other activities,            at the Donald W. Reynolds Center, and
there was still ample time to shop             the first full day began with breakfast
London! The 2008 conference                    at the National Gallery of Art, where

                                                                                             T
                                                                                                   hese were our first twenty years
culminated with a very memorable               we heard a summary of the museum                    of IAMFA—and IAMFA has now
closing Gala in the Earth Gallery at           benchmarking exercise, which also set               grown to more than 200 members
the Natural History Museum. John               a record for participation. We heard          in eight countries.
de Lucy was elected President at the           presentations on building automation             But . . . where in the world will
annual business meeting during the             systems, sustainability, budget planning      IAMFA go next?
London conference.                             and reliability-centered maintenance.
   In 2008, IAMFA also became an               We visited the National Museum of
Affiliated Association of the International    the American Indian, which was in the         San Francisco—2010
Council of Museums (ICOM).                     process of applying for LEED Certifica-       We will be meeting in San Francisco
                                               tion. We toured the Library of Congress,      on October 17–20, 2010. You can read
Washington, D.C.—2009                          the National Archives Building, and the       more about the upcoming conference
In 2009, IAMFA members met in                  new Capitol Visitor Center, as well as        in this issue of Papyrus. See you there!
Washington, D.C., attending venues             the oldest Smithsonian Building, The
in both Washington and Baltimore.              Castle. The closing Gala was held in
Nancy Bechtol was our host, and we set         the Thomas Jefferson Building of the
attendance records again this year, just       Library of Congress, which contains
as we had the previous year in London.         some of the richest public interiors in

                                                                                             The New LEED Platinum California Academy
                                                                                             of Sciences in San Francisco.

                                                                                             Auckland, New Zealand—
                                                                                             2011

                                                                                             The 2011 IAMFA conference will be held
The closing Gala for the most recent IAMFA annual conference was held in the Great Hall of   in Auckland, New Zealand on November
the Library of Congress Thomas Jefferson Building in Washington, D.C. in November 2009.      13–17, 2011.

                                                                                               PAPYRUS SUMMER–FALL 2010           13
Mid-Atlantic, U.S.—2012                    We believe doing so will allow our               From Pierre Lepage, the original
                                           members to be better educated and             editor of IAMFA’s Papyrus publication,
                                           better equipped to serve the mission          ā€œThis Association has taken a quantum
                                           of their institutions.                        leap in the development of its annual
                                              In pursuit of these goals, the associa-    conferences. The change of location
                                           tion sponsors an annual conference, and       each year creates tremendous potential
                                           communicates quarterly with its mem-          for conference organizers to diversify
                                           bership and friends around the world          conference activities, making each
                                           through the IAMFA journal Papyrus.            conference unique and memorable.
                                                                                         For the organizers, it also becomes a
                                           Membership and                                truly collegial experience, giving mem-
                                                                                         bers of the organizing committee an
                                           Educational Benefits,                         opportunity to work closely with one
The 2012 IAMFA conference is set for       Annual Meeting and
the U.S. Eastern Seaboard, including                                                     another during the two years it takes
the Winterthur Garden and Museum in        Conference                                    to prepare for the event. The confer-
Delaware.                                  IAMFA brings museum facility adminis-         ence is also an opportunity to show-
                                           trators together to promote creativity        case the best cultural institutions in the
Boston—2013                                and foster dialogue within the interna-       host city. In addition, participants get
                                           tional museum community, in order             an unequalled chance to learn from
                                           to better serve the missions and goals        colleagues about different management
                                           of all museums and cultural organi-           approaches, to witness progress on con-
                                           zations. Member museums host the              struction sites, and to find out about
                                           annual conference, which includes             successes with recent museum renova-
                                           seminars, meetings, roundtable dis-           tions and museum-related construction
                                           cussions and panels on topics chosen          projects around the world.ā€
                                           by the membership. These educational
                                           sessions draw upon the knowledge and          Contributors:
                                           talents of many well-respected experts        John Castle, Director, Facility Services,
                                           in their fields. The variety of host cities   Winterthur Museum & Garden, Winterthur,
                                           and facilities affords members the            Delaware, U.S.A.
The 2013 IAMFA conference is planned
                                           opportunity to see, experience and            Daniel Davies, Zone Facilities Manager,
for Boston, Massachusetts.
                                           learn from the world’s most renowned          National Zoo, Washington, D.C.
                                           cultural institutions. Sponsorship from       John de Lucy, Head of Estates & Facilities,
IAMFA Statement of                         the businesses that provide support to        British Library, London
Purpose                                    our museums, along with an oppor-             Peter Fotheringham, Head of Estates,
The International Association of           tunity to see their latest products and       University of Greenwich, London
Museum Facility Administrators is an       technologies, round out the                   Guy Larocque, Director, Facility
international educational organization     conference experience for members.            Management and Security Services,
                                                                                         Canadian Museum of Civilization
devoted to meeting the professional           According to John Castle, current          Corporation, Ottawa-Gatineau, Canada
needs of museum facility administra-       Vice-President of IAMFA Regional
                                                                                         Pierre Lepage (retired), Canadian Museum
tors—especially their efforts to set and   Affairs, ā€œOne of the great things that I      of Civilization Corporation,
maintain standards of excellence and       love about IAMFA is that each year it         Ottawa/Gatineau, Canada
quality in the design, construction,       holds an annual conference where up           Vincent Magorrian (retired), Museum
operation and maintenance of world-        to a hundred delegates plus their guests      of Modern Art, New York City
class cultural facilities.                 meet in one of the world’s great cities       Joe May, Sustainability Engineer,
   IAMFA earnestly desires to promote      to share their experiences of managing        Los Angeles
and foster communications between          the hard and soft facilities services in      Marla Neustadt, Operational Support
facilities professionals at museums        some of the most iconic institutions in       Services, NASA Headquarters,
as well as other cultural facilities.      the world.ā€                                   Washington, D.C.

                                 Become a Member of IAMFA
                                     For more information on becoming a member of the
                           International Association of Museum Facility Administrators, please visit
                                                            WWW.IAMFA.ORG

14     PAPYRUS SUMMER–FALL 2010
The Twentieth Annual IAMFA
Conference in San Francisco
La Vingtième Conférence
de l’IAMFA Ć  San Francisco
La VigƩsima Conferencia Anual
de IAMFA en San Francisco

T                                             L                                            E
       he 2010 IAMFA San Francisco                 ’équipe de la ConfĆ©rence de                   l equipo de trabajo de la con-
       conference team looks forward               l’IAMFA Ć  San Francisco se rĆ©jouit            ferencia anual de IAMFA del
       to welcoming all IAMFA members              d’accueillir tous les membres et              2010 en San Francisco estĆ”n con
and guests to the Twentieth Annual            leurs invités à la 20ième assemblée          ganas de darle la bienvenida a la vigé-
IAMFA Conference. Everyone involved           annuelle. Tous les participants ont          sima conferencia anual de IAMFA
has worked hard to develop a program          travaillƩ fort pour dƩvelopper un pro-       en San Francisco. Todas las personas
packed with educational content, tours,       gramme riche en contenu Ʃducatif,            involucradas han trabajado duro para
and networking opportunities that you         des visites guidƩes et des possibilitƩs de   desarrollar un programa repleto de
will be able to use in managing your          rƩseautage que vous seriez en mesure         contenido educacional, giras, y opor-
facility. And the city of San Francisco       d’utiliser dans la gestion de votre Ć©ta-     tunidades para trabajar en las redes
offers a stunning setting that is virtually   blissement. Et la ville de San Francisco     de contactos que podrƔn utilizar para
unrivaled in the wealth of its cultural       offre un cadre somptueux qui est pra-        la administración de su instalación.
institutions.                                 tiquement inƩgalisƩ dans la richesse         Y la ciudad de San Francisco ofrece
   The members’ program includes              de ses institutions culturelles.             un entorno increĆ­ble con un nĆŗmero
numerous presentations on topics in              Le programme des membres inclut           infinito de instituciones culturales casi
which you have expressed an interest,         de nombreuses prƩsentations sur des          sin igual.
including:                                    sujets dans lesquels vous avez exprimƩ          El programa de los miembros incluye
                                              un intérêt; notamment:                       numerosas presentaciones sobre temas
• LED Lighting in the Museum
                                                                                           en los cuales Ustedes han demostrado
  Environment                                 • L’utilisation d’éclairage LED dans         un interĆ©s, incluyendo:
• Seismic Resistance and the History            les musĆ©es
  of the Cantor Arts Center                                                                • el uso de luces LED en los museos
                                              • RĆ©sistance sĆ©ismique et l’histoire
• Forward Planning: IAMFA’s Next                du Centre d’arts Cantor                    • la resistencia sĆ­smica y la historia
  Five Years                                                                                 del Centro de Artes Cantor
                                              • Planification du future: l’IAMFA
• The de Young Museum: Five Years               dans les cinq prochaines annĆ©es            • planificación para El Futuro: los
  of Lessons Learned                                                                         próximos cinco años de IAMFA
                                              • Le musĆ©e de Young : cinq ans de
• Summary of the 2010 Benchmarking              leƧons apprises
                                                                                           • el Museo de De Young: cinco aƱos
  and Best Practices Exercise
                                              • RĆ©sumĆ© de l’analyse comparative              de lecciones aprendidas
• Green Historic Preservation: The              2010 et les meilleures pratiques de
  Mint Project                                                                             • resumen del ejercicio de 2010 de
                                                l’exercise du ā€˜Benchmarking’
                                                                                             evaluación comparativa (bench-
• Operating a LEED Platinum                   • PrĆ©servation historique orientĆ©e             marking) y mejores prĆ”cticas del
  Building                                      au dƩveloppement soutenable: le              ejercicio
• Annual IAMFA Business Meeting                 projet Mint
                                                                                           • la preservación histórica orientada
• Innovation in the Exploratorium’s           • Fonctionnement d’un bĆ¢timent                 al desarrollo sostenible: el proyecto
  New Plans                                     LEED Platine                                 Mint

                                                                                             PAPYRUS SUMMER–FALL 2010          15
• Award-Winning Historical Preser-          • AssemblĆ© annuelle des affaires de         • la operación de un edificio LEED
               vation—The Walt Disney Family               l’IAMFA                                     platino
               Museum
                                                         • Innovation dans les nouveaux plans        • reunión anual de IAMFA de
                                                           de l’Exploratorium                          planificación
                A range of fascinating behind-the-
             scenes and gallery tours are also on        • Prix gagnĆ© pour prĆ©servation histo-       • innovación en los nuevos planos
             the agenda, along with a great guest          rique – le MusĆ©e de la Famille de           del Exploratorium
             program. This year’s conference venues,       Walt Disney
                                                                                                     • un ejemplo de preservación histórica
             in and around San Francisco, are
                                                                                                       ganador de premio—el Museo de
             described below.                                Une gamme fascinante de tournƩes
                                                                                                       La Familia de Walt Disney
                                                         Ā« dans-les-coulisses Ā» et de visites gui-
             San Francisco Museum                        dĆ©es sont Ć©galement dans l’itinĆ©raire,
                                                                                                         Una gama de giras fascinantes tras
             of Modern Art                               avec un programme excellent pour
                                                                                                     bastidores y de galerƭas tambiƩn estƔ en
             The San Francisco Museum of Modern          nos hƓtes. Les lieux de rendez-vous Ơ
                                                                                                     el itinerario, ademƔs de un programa
             Art celebrated its 75th anniversary in      l’intĆ©rieur et autour de San Francisco
                                                                                                     excelente para los invitados. Los en-
             January 2010 (now, doesn’t that sound       pendant la confĆ©rence de cette annĆ©e
                                                         sont dƩcrits ensuite, ci-dessous.           tornos de la conferencia de este aƱo,
             like an oxymoron: Modern and 75                                                         dentro de y alrededor de San Francisco,
             years?). The Museum was originally                                                      se describen a continuación.
             housed in the War Memorial Building         Le MusĆ©e d’art moderne
             in the Civic Center across the street       de San Francisco
                                                                                                     El Museo de Arte Moderno
             from City Hall, sharing the building        Le MusĆ©e d’art moderne de San
                                                                                                     de San Francisco
             with veterans’ organizations and the        Francisco a cĆ©lĆ©brĆ© son 75e anniver-
             Herbst Theater. When it opened its          saire en janvier 2010 (Ƨa ne sonne          El Museo de Arte Moderno de San
             doors in January 1935, it was consid-       pas comme un oxymoron: moderne              Francisco celebró su 75a aniversario
             ered a pioneer in the field of modern       et 75 ans?). Le musée fut installé dans     en enero 2010 (¿no suena un poco
             art collection and display. It also had     l’édifice commĆ©moratif de la guerre         contradictorio los tĆ©rminos moderno
             one of the first photography collections    dans le Centre civique en face de           y 75 aƱos?). Originalmente el Museo
             in the museum world, acknowledging          l’HĆ“tel de ville, partageant le bĆ¢timent    se encontraba en el Edificio Conme-
             photography as an art form well before      avec des organisations d’anciens com-       morativo de la Guerra en el Centro
             many of its contemporaries.                 battants et le Théâtre Herbst. Lorsqu’il    CĆ­vico en frente del Ayuntamiento, y
                By the 1980s, the Museum had out-        a ouvert ses portes en janvier 1935, il     compartĆ­a el edificio con las organiza-
             grown its original quarters, and planning   a ƩtƩ considƩrƩ comme un pionnier           ciones de los veteranos de las guerras
             began for a new purpose-built facility.     dans le domaine de la collection d’art      y el Teatro Herbst. Cuando abrió sus
             Architect Mario Botta was selected to       moderne et d’affichage. Il Ć©tait Ć©gale-     puertas en enero de 1935, se lo con-
             design the signature building on Third      ment l’une de premiĆØres collections         sideró un pionero en el campo de
                                                                                                     la colección y la exhibición de arte
                                                                                                     moderno. TambiƩn a travƩs de una
                                                                                                     de las primeras exhibiciones de foto-
HENRIK KAM

                                                                                                     grafĆ­as en el mundo de los museos,
                                                                                                     reconoció a la fotografía como arte
                                                                                                     antes que muchos de los otros museos.
                                                                                                        Para los 1980s, el Museo habĆ­a cre-
                                                                                                     cido demasiado para su alojamiento
                                                                                                     original y se comenzó a planear una
                                                                                                     nueva instalación construida expresa-
                                                                                                     mente para museo. El arquitecto
                                                                                                     Mario Botta fue seleccionado para
                                                                                                     diseñar el edificio único en la calle
                                                                                                     tercera., al sur de la calle Market. Para
                                                                                                     algunos miembros de la sociedad de
                                                                                                     San Francisco, esta idea les pareció
                                                                                                     herejĆ­a, no era aceptable ir al ā€œsur de
                                                                                                     la ranuraā€ (ā€œla ranuraā€ se referĆ­a a la
                                                                                                     ranura en la calle para el tranvĆ­a) Sin
                                                                                                     embargo, la selección de este vecin-
                                                                                                     dario resultó visionaria, ya que este
                                                                                                     Ɣrea al sur de la calle Market estaba
             The San Francisco Museum of Modern Art.                                                 en proceso de expansión y de revitali-

             16     PAPYRUS SUMMER–FALL 2010
Street, south of Market Street. For some    de photographie dans le monde des             zación, en el cual tomaría un papel
                                                 members of San Francisco society, this      musƩes, en reconnaissant la photo-            importante el museo. Cuando el edifi-
                                                 was heresy: one just didn’t go ā€œsouth       graphie comme une forme d’art bien            cio actual se inauguró en enero 1995,
                                                 of the slotā€ (ā€œslotā€ referring to the       avant que ses contemporains.                  recibió la aclamación de los crĆ­ticos, y
                                                 cable car slot in the street). The move        Dans les annƩes 1980, le MusƩe avait       hasta la fecha nunca ha frenado en
                                                 was visionary, however, as the ā€œSouth       dĆ©passĆ© ses limites d’origine, et on a        su afĆ”n de mantener un programa
                                                 of Marketā€ area was undergoing an           commencĆ© Ć  planifier une nouvelle             atrevido de exhibiciones y un alto
                                                 expansion and revitalization, in which      installation construite à cet effet.          nivel de excelencia en conservación.
                                                 the Museum was to play a pivotal role.      L’architecte Mario Botta a Ć©tĆ© choisi
                                                 The Museum opened in its current            pour concevoir le bâtiment signature          Exploratorium
                                                 building in January 1995 to rave reviews,   sur la rue 3e, au sud de la rue du            El Exploratorium es un museo experi-
                                                 and has never slowed down in provid-        MarchƩ. Pour certains membres de la           mental diseƱado para fomentar la
                                                 ing both a bold exhibition program and      société de San Francisco, ce fut une          curiosidad a través de la interacción
                                                 a high standard of curatorial excellence.   hƩrƩsie: on ne va pas tout simplement         fƭsica del visitante con las exhibiciones
                                                                                             aller Ā« au sud de la fente Ā» (se rĆ©fĆ©rant     —sin importar la edad del visitante o
                                                 Exploratorium                               Ơ la fente tƩlƩphƩrique dans la rue).         su conocimiento de la ciencia. Atrae a
                                                 The Exploratorium is an experimental,       Le déménagement a été visionnaire,            los mayores, los jóvenes, los artistas,
                                                 hands-on museum designed to spark           toutefois, et la zone au sud de la rue        los cientĆ­ficos, los individuos que han
                                                 curiosity—regardless of a visitor’s age     du MarchĆ© a Ć©tĆ© l’objet d’une expan-          sido premiados con el premio Nobel,
                                                 or familiarity with science. It attracts    sion et d’une revitalisation, dans lequel     las familias, y a todos los demĆ”s. Este
                                                 the old, the young, artists, scientists,    le MusƩe a jouƩ un rƓle central. Le           museo que parece combinar elementos
                                                 Nobel laureates, families, and every-       Musée a ouvert dans son bâtiment              de una galería de mÔquinas de traga-
                                                 one in between. Like a mad scientist’s      actuel en janvier 1995 avec des cri-          perras de un cientĆ­fico loco, una casa
                                                 penny arcade, a scientific funhouse,        tiques Ć©logieuses, et n’a jamais ralenti      de espejos de Ć­ndole cientĆ­fica, un estu-
                                                 an art studio and an experimental           l’offre d’un programme d’expositions          dio de arte y un laboratorio experi-
                                                 laboratory all rolled into one, you can     audacieux et, Ć  la fois, d’un haut niveau     mental ofrece la oportunidad de tocar,
                                                 touch, play, and tinker with hundreds       d’excellence de conservation.                 jugar y manipular centenares de exhi-
                                                 and hundreds of exhibits. In short,
                                                                                                                                           biciones. En breve, es una institución
                                                 it’s a public educational institution       L’Exploratorium                               educacional pĆŗblica para visitantes de
                                                 for visitors of all ages.
                                                                                             L’Exploratorium c’est un projet expĆ©-         todas las edades.
                                                     This innovative museum of science,
                                                                                             rimental, un musƩe aux-mains conƧu                Este museo innovador de ciencias,
                                                 technology, art and human percep-
                                                                                             pour éveiller la curiosité, indépen-          tecnología, arte, y la percepción
                                                 tion provides the general public—
                                                                                             damment de l’âge du visiteur et de sa         humana provee al pĆŗblico en general
                                                                                             familiaritĆ© avec la science. Elle attire      —aun con un conocimiento limitado
AMY SNYDER Ā© EXPLORATORIUM – EXPLORATORIUM.EDU

                                                                                             les vieux, les jeunes, artistes, scienti-     de ciencias—de una experiencia que
                                                                                             fiques, laurƩats du prix Nobel, les           les ayuda a entender mejor la ciencia y
                                                                                             familles et tous les autres. Comme le         la naturaleza. Para el 2010, el pĆŗblico
                                                                                             savant fou Penny Arcade, le scienti-          del Exploratorium se estima en mƔs
                                                                                             fique drĆ“le, un studio d’art et un labo-      de 20 millones para las exhibiciones
                                                                                             ratoire expƩrimental tout en un, vous         en los centros de ciencia y otros lugares
                                                                                             pouvez toucher, jouer et bricoler avec        alrededor del mundo. MƔs de 575,000
                                                                                             des centaines et des centaines d’expo-        visitantes vendrĆ”n al Exploratorium
                                                                                             sitions. En bref, ceci s’agit d’un Ć©tablis-   en San Francisco en 2010 para inter-
                                                                                             sement d’enseignement public pour             actuar con las exhibiciones originales;
                                                                                             les visiteurs de tous ages.                   6,000 maestros participarƔn en los
                                                                                                 Ce musƩe innovant de la science,          programas de desarrollo profesional;
                                                                                             la technologie, l’art et la perception        110,000 estudiantes y maestros harĆ”n
                                                                                             de l’homme prĆ©voit le grand public,           excursiones escolares y 5,000 estudi-
                                                                                             même ceux qui ont très peu de con-            antes mÔs, muchos que provienen
                                                                                             naissances scientifiques, avec une expƩ-      de los vecindarios de bajos recursos,
                                                                                             rience qui les aide Ơ mieux comprendre        recibirƔn beneficios por medio del
                                                                                             la science et la nature. Pour 2010, les       Programa de difusión pública para la
                                                                                             visiteurs Ć  l’Exploratorium sont estimĆ©s      Educación de Jóvenes. Todos los aƱos
                                                                                             Ć  plus de 20 million pour les exposi-         se venden 5,000 ejemplares de las publi-
                                                                                             tions dans les centres de sciences et         caciones del Exploratorium, y su sitio
                                                                                             d’autres endroits dans le monde entier.       de Internet recibe 24 millones de visitas
                                                 Inside the Exploratorium.                   Plus de 575 000 visiteurs viendront Ơ         durante el aƱo. En el 4to Congreso

                                                                                                                                             PAPYRUS SUMMER–FALL 2010          17
even those with very limited scientific     l’Exploratorium lui-mĆŖme en 2010            Mundial de Centros de Ciencias en
knowledge—with an experience that           pour interagir avec les originaux expo-     RĆ­o de Janeiro en 2005, los centros de
helps them to better understand science     sitions les mains sur les piĆØces; 6 000     ciencias de cinco continentes le con-
and nature. For 2010, the Explorato-        enseignants feront partie des pro-          cedieron al Exploratorium el primer
rium’s audience is estimated at more        grammes de perfectionnement profes-         puesto.
than 20 million for exhibits at science     sionnel; 110 000 Ʃtudiants et professeurs
centers and other locations worldwide.      se rendront sur des sorties scolaires et    Las Bibliotecas de la
More than 575,000 visitors will come        un autre groupe de 5 000 Ʃtudiants          Universidad de Stanford
to the Exploratorium itself in 2010 to      d’un grand nombre de quartiers insuf-       Fue fundada en 1885 por Jane y Leland
interact with the original, hands-on        fisamment desservis de San Francisco        Stanford, en honor de su Ćŗnico hijo.
exhibits; 6,000 teachers will participate   va se bĆ©nĆ©ficier du Programme d’exten-      La Universidad de Leland Stanford
in professional development programs;       sion educative pour l’enfance. Chaque       Junior abrió en 1891. El primer presi-
110,000 students and teachers will visit    annƩe, 50 000 exemplaires de publica-       dente de Stanford, David Starr Jordan,
on school field trips; and another 5,000    tions de l’Exploratorium sont vendus        escribió que ā€œuna gran biblioteca es
students, many from San Francisco’s         et son laurĆ©at site Web reƧoit 24 mil-      el elemento mĆ”s importante en la for-
underserved neighborhoods, will bene-       lion de visites durant l’annĆ©e. Lors du     mación de una gran universidad.ā€ Las
fit from the Children’s Educational         4e CongrĆØs mondial des centres scien-       colecciones de la biblioteca crecieron
Outreach Program. Each year, 50,000         tifiques Ć  Rio de Janeiro en 2005, les      lentamente pero sin parar durante
copies of Exploratorium publications        représentants venus des cinq continents     el próximo cuarto de siglo, mientras
are sold, and its award-winning website     ont classĆ© l’Exploratorium comme            la biblioteca padecĆ­a de dificultades
receives 24 million visits during the       le numƩro un parmi les centres de           financieras despuƩs del terremoto
year. At the 4th Science Center World       sciences du monde.                          devastador de 1906. Un edificio central
Congress in Rio de Janeiro in 2005, sci-                                                para la biblioteca que fue construido
ence centers from five continents ranked    BibliothĆØques de l’UniversitĆ©               especĆ­ficamente para ese propósito y
the Exploratorium as the number one         de Stanford                                 que ahora se conoce como el Ala Bing
science center in the world.                Fondée en 1885 par Jane et Leland           de la Biblioteca Green abrió en 1919.
                                            Stanford, en souvenir de leur enfant        Hoy, hay 20 bibliotecas en el campus:
Stanford University Libraries               unique, l’UniversitĆ© Leland Stanford        cinco bibliotecas independientes (Leyes,
Founded in 1885 by Jane and Leland          Junior a ouvert ses portes en 1891. Le      Administración de Empresas, Medi-
Stanford as a memorial to their only        premier président de Stanford, David        cina, el Centro de Aceleración Lineal
child, Leland Stanford Junior Univer-       Starr Jordan, a écrit que « une grande      Stanford, y el Instituto Hoover) que
sity opened in 1891. Stanford’s first       bibliothĆØque est l’élĆ©ment le plus          reportan a su decano o director; mien-
president, David Starr Jordan, wrote        important dans la formation d’une           tras que las demĆ”s bibliotecas estĆ”n
that, ā€œa great library is the most impor-   grande universitĆ© Ā». Les collections de     consolidadas como las Bibliotecas de
tant element in the formation of a great    la Bibliothèque ont augmenté lente-         la Universidad de Stanford y Recursos
University.ā€ The Library’s collections      ment mais rĆ©guliĆØrement au cours            de Información AcadĆ©mica (SULAIR)
grew slowly but steadily over the next      du prochain quart de siĆØcle, puisque        y reportan a la bibliotecaria de la
quarter century, as the University strug-   l’UniversitĆ© luttait avec des difficultĆ©s   universidad.
gled with financial difficulties in the
aftermath of the devastating 1906 earth-                                                El Centro de Arte Cantor
quake. A purpose-built main library                                                     Las colecciones diversas del Centro
building, now known as the Bing Wing                                                    de Arte Cantor abarcan continentes,
of Green Library, opened in 1919.
Today, there are 20 libraries on campus:                                                                                           RICHARD BARNES

five coordinate libraries (Law, Business,
Medicine, the Stanford Linear Acceler-
ator Center, and the Hoover Institution)
report to their dean or director, while
the remaining libraries are organized
centrally as the Stanford University
Libraries and Academic Information
Resources, or SULAIR, reporting to
the University Librarian.

Cantor Arts Center
The Cantor Arts Center’s diverse col-
lections span continents, cultures, and     The Green Library at Stanford University.   The Cantor Arts Center.

18     PAPYRUS SUMMER–FALL 2010
4,000 years of art history, and include      financières après le tremblement de              culturas, y 4,000 años de historia de
                                                           the largest gathering of Rodin bronzes       terre devastateur de 1906. Le bâtiment           arte e incluyen el grupo mÔs grande
                                                           outside Paris. The Center’s distinguished    de la bibliothĆØque construit Ć  cet effet,        de esculturas de bronce de Rodin
                                                           outdoor art collection includes impor-       maintenant connu comme l’aille Bing              fuera de ParĆ­s.
                                                           tant figurative and abstract works in a      de la BibliothĆØque Green, est ouvert
                                                           variety of media by artists of the late      en 1919. Aujourd’hui, il existe 20 bib-          Museo ContemporĆ”neo JudĆ­o
                                                           nineteenth century to the present.           liothĆØques sur le campus: cinq biblio-           Con la apertura de su nuevo edificio en
                                                                                                        thèques coordonnées (droit, commerce,            junio 2008, el Museo ContemporÔneo
                                                           Contemporary Jewish Museum                   mĆ©decine, le Centre Stanford d’accel-            JudĆ­o comenzó un nuevo capĆ­tulo
                                                           With the opening of its new building in      eration linĆ©aire, et l’Institution Hoover)       despuĆ©s de mĆ”s de 20 aƱos de invo-
                                                           June 2008, the Contemporary Jewish           se rapportent Ć  leur doyen ou direc-             lucrar al pĆŗblico y a los artistas en una
                                                           Museum ushered in a new chapter in           teur, alors que le reste des bibliothèques       exploración de perspectivas contem-
                                                           more than 20 years of engaging audi-         sont encore organisées de manière                porÔneas de la cultura, la historia,
                                                           ences and artists in exploring contem-       centralisée, comme les bibliothèques             el arte, y las ideas judías. La nueva
                                                           porary perspectives on Jewish culture,       de l’UniversitĆ© de Stanford et les Res-          instalación premiada, diseƱada por el
                                                           history, art, and ideas. The new award-      sources d’information acadĆ©mique ou              arquitecto de fama mundial, Daniel
                                                           winning facility, designed by interna-       SULAIR, dƩpendant du bibliothƩcaire              Libeskind, es un centro dinƔmico
                                                           tionally renowned architect Daniel           de l’UniversitĆ©.                                 donde todos pueden reunirse para
                                                           Libeskind, is a lively center where people                                                    experimentar el arte, compartir per-
                                                           of all ages and backgrounds can gather       Centre des arts Cantor                           spectivas diversas, y participar de lleno
                                                           to experience art, share diverse per-        Les diverses collections du Centre des           en exhibiciones prƔcticas sin importar
                                                           spectives, and engage in hands-on activ-     arts Cantor couvrent des continents,             la edad ni el origen de los visitantes.
                                                           ities. Inspired by the Hebrew phrase         des cultures, et 4 000 ans d’histoire            Inspirado en la frase hebrea ā€œL’Chaimā€
                                                           ā€œL’Chaimā€ (To Life), the building is a       de l’art, et notamment le plus grand             (A la Vida), el edificio es una mani-
                                                           physical embodiment of the Contem-           rassemblement des bronzes de Rodin               festación física de la misión del Museo
                                                           porary Jewish Museum’s mission to            en dehors de Paris.                              ContemporĆ”neo JudĆ­o de unir la tra-
                                                           bring together tradition and innova-                                                          dición y la innovación en la exploración
                                                           tion in an exploration of the Jewish         Le Museum juif contemporain                      de la experiencia judĆ­a en el siglo veinte
                                                           experience in the twenty-first century.      Avec l’ouverture de son nouveau bĆ¢ti-            y uno.
                                                                                                        ment en Juin 2008, le MusƩe juif con-
                                                           de Young Museum                              temporain a inaugurƩ un nouveau                  Museo de Young
                                                           The de Young Museum, housed in a             chapitre de plus de 20 ans d’engage-             El Museo de Young, ubicado en un
                                                           landmark building designed by Herzog         ment avec le public et les artistes explo-       edificio de reconocida importancia
                                                           & de Meuron and located in Golden            rant les perspectives contemporaines             diseƱado por Herzog & de Meuron y
                                                           Gate Park, is the fourth most-visited        sur la culture juive, l’histoire, l’art et les   situado en el Parque Golden Gate, es
                                                                                                        idées. Le nouvel établissement lauréat,          el museo de arte número cuatro en
                                                                                                        conƧu par l’architecte internationale-           cantidad de visitantes en los EEUU, y
BRUCE DAMONTE/COURTESY OF THE CONTEMPORARY JEWISH MUSEUM

                                                                                                        ment renommƩ Daniel Libeskind, est               tiene el puesto dƩcimo sexto en visitas
                                                                                                        un centre animé où des personnes                 a los museos a nivel mundial. Sus
                                                                                                        de tous Ć¢ges et origines peuvent s’y             exhibiciones contienen arte americano
                                                                                                        retrouver pour vivre l’art, Ć  partir de          desde el siglo diez y siete hasta el siglo
                                                                                                        leurs perspectives diffƩrentes, et de            veintiuno; arte textil y vestimenta inter-
                                                                                                        s’engager dans des activitĆ©s pratiques.          nacional; arte de Ɓfrica, de las AmĆ©ricas,
                                                                                                        InspirĆ© par l’expression hĆ©braĆÆque               la región de Asia y del PacifĆ­co.
                                                                                                        Ā« L’Chaim Ā» (Ć  la vie), le bĆ¢timent est
                                                                                                        un mode de rƩalisation physique de la
                                                                                                        mission du MusƩe juif contemporain
                                                                                                        de rĆ©unir la tradition et l’innovation
                                                                                                        dans une exploration de l’expĆ©rience
                                                                                                        juive dans le XXIe siĆØcle.

                                                                                                        Le MusƩe de Young
                                                                                                        Le musƩe de Young, abritƩ dans un
                                                                                                        bâtiment conçu par Herzog & de
                                                                                                        Meuron et situƩ dans le Parc Golden
                                                                                                        Gate, est le quatriĆØme musĆ©e d’art le
                                                           The Contemporary Jewish Museum               plus visitĆ© aux Ɖtats-Unis, et le 16e musĆ©e      The de Young Museum.

                                                                                                                                                           PAPYRUS SUMMER–FALL 2010           19
art museum in the United States, and          d’art le plus visitĆ© du monde. Il met en      La Academia de Ciencias
the 16th most-visited art museum in the       valeur l’art amĆ©ricain du dix-septiĆØme        de California
world. It showcases American art from         au vingt et uniĆØme siĆØcles, les arts tex-     Hogar del Acuario Steinhart, el Museo
the seventeenth through the twenty-           tiles et des costumes internationaux          de Historia Natural Kimball, el Plane-
first centuries, international textile        et l’art des AmĆ©riques, de la rĆ©gion          tarium Morrison, y programas de
arts and costumes, and art from the           du Pacifique et de l’Afrique.                 investigación y educación de calidad
Americas, the Pacific Rim, and Africa.                                                      mundial, la Academia de Ciencias de
                                              L’AcadĆ©mie des sciences                       California es uno de los destinos. Desde
California Academy of Sciences                de la Californie                              los pingüinos chapoteando hasta las
Home to the Steinhart Aquarium, the           Accueil de l’Aquarium Steinhart, le           flores silvestres en el techo, el edifico
Kimball Natural History Museum, the           MusĆ©e d’histoire naturelle Kimball,           estĆ” rebosante de vida.
Morrison Planetarium, and world-class         le planƩtarium Morrison, et des pro-             Un bosque tropical de cuatro pisos
research and educational programs,            grammes mondiaux de recherche et              y un magnifico sistema ecológico
the California Academy of Sciences is         Ć©ducatifs, l’AcadĆ©mie des sciences de         de coral deleitarĆ”n a los visitantes
one of San Francisco’s must-see desti-        la Californie est l’une des destinations      de todas las edades, mientras que el
nations. From the splashing penguins          Ơ voir Ơ San Francisco. Des Ʃclabouss-        programa del espacio sumerge a su
in African Hall to the wildflowers on         ures des penguins Ć  la salle de l’Afrique     pĆŗblico en una experiencia que trans-
the roof, the building is bursting with       jusqu’aux fleurs sauvages sur le toit, le     porta a los participantes mĆ”s allĆ” de las
life. A four-story living rainforest and      bâtiment est plein de vie. Une forêt de       fronteras de nuestra planeta. Abundan
awe-inspiring coral reef ecosystem will       vie de quatre Ʃtages et un impression-        las oportunidades para conocer a los
delight visitors of all ages, while immer-    nant écosystème de récifs coralliens          científicos de la Academia, compartir
sive Space shows transport audiences          raviront les visiteurs de tous âges, tandis   sus descubrimientos y sumarse al
beyond the boundaries of our planet.          que le spectacle de l’espace immersif         movimiento para convertir a nuestro
Opportunities abound to meet Academy          transport le public au-delĆ  des limites de    mundo en un lugar donde vivamos en
scientists, share in their discoveries, and   notre planète. Les débouchés abondent         armonía ecológica de una manera
join the journey to make our world            pour se rencontrer avec des scienti-          sostenible.
a greener, more sustainable place in          fiques de l’AcadĆ©mie, partager leurs
which to live.                                dƩcouvertes, et rejoindre la route pour       Museo de la Familia
                                              rendre notre monde plus vert, un lieu         de Walt Disney
Walt Disney Family Museum                     plus durable pour vivre.                      Walt Disney fue uno de los personajes
Walt Disney was one of the most influ-                                                      mƔs influyentes del siglo veinte y su
ential figures of the twentieth century,      Le MusƩe de la famille                        popularidad mundial sigue hasta la
and his worldwide popularity lives on         de Walt Disney                                fecha. Con la ayuda de pelĆ­culas de
to this day. Through animated and             Walt Disney a Ć©tĆ© l’une des personna-         dibujos animados y de acción en vivo,
live-action films, television shows and       lités les plus influentes du XXe siècle,      programas de televisión y parques
theme parks, Disney created global            et sa popularité vit dans le monde entier     temÔticos, Disney creó símbolos glo-
symbols, stories and characters that are      à ce jour. Grâce aux films animés et les      bales, historias y personajes que son
an indelible part of our popular cul-         films d’action, des Ć©missions de tĆ©lĆ©vi-      una parte indeleble de nuestra cultura
ture. The Walt Disney Family Museum           sion et des parcs thƩmatiques, Disney a       popular. El museo de la Familia de Walt
was conceived to present the real story       crƩƩ des symboles globaux, des histoires      Disney fue concebido para presentar

The California Academy of Sciences.                                 The Walt Disney Family Museum.

20     PAPYRUS SUMMER–FALL 2010
of Walt Disney the man, as told by him      et des personnages qui font partie indƩ-              la verdadera historia de Walt Disney, el
and by others who knew him well. The        lƩbile de notre culture populaire. Le                 hombre, contado por Ʃl y por quienes
Museum is located in the Presidio of        MusƩe de la famille de Walt Disney a                  lo conocƭan bien. El museo se ubica
San Francisco: a former U.S. Army base      ƩtƩ conƧu pour prƩsenter la vƩritable                 en el Presidio de San Francisco; una
that is now a National Park. The three      histoire de Walt Disney l’homme, telle                base de la armada de EEUU que ahora
buildings that house the Museum are on      que racontĆ©e par lui et par d’autres qui              es un parque nacional. Los tres edi-
the National Register of Historic Places.   le connaissaient bien. Le MusƩe est situƩ             ficios que contienen el museo estƔn en
                                            dans le Presidio de San Francisco: une                la lista nacional de lugares históricos
San Francisco Maritime Museum               ancienne base de l’armĆ©e amĆ©ricaine                   de EEUU.
The San Francisco Maritime Museum           qui est maintenant un parc national.
is located in the Aquatic Park Historic     Les trois bâtiments qui abritent le                   El Museo Marítimo
District: a National Historic Landmark      musƩe sont sur le Registre national                   de San Francisco
located on San Francisco Bay. The           des lieux historiques.                                Ubicado en el distrito histórico del
Park’s distinctive Streamline Modern                                                              Parque AcuĆ”tico en la bahĆ­a de
style WPA building stands at the foot       Le MusƩe maritime                                     San Francisco, el Museo Marƭtimo
of Polk Street. It was originally built     de San Francisco                                      de San Francisco aparece en la lista
as a public bathhouse in 1936, and          Le Musée maritime de San Francisco                    nacional de edificios históricos. El
now houses the Maritime Museum. Its         est situƩ dans le district historique du              edificio WPA del distintivo estilo
interior is decorated with fantastic and    Parc aquatique: un point historique                   aerodinƔmico se encuentra al pie
colorful murals. Although the Museum        de répère national situé sur la baie de               de la calle Polk. Originalmente se
is currently under renovation, IAMFA        San Francisco. Le distinctif bâtiment                 construyó como una sauna pública en
is fortunate to be able to host the Gala    du Parc (un des Ā« WPA buildings Ā») Ć                   1936, y ahora es el hogar del Museo
dinner of its 20th annual conference        style Ā« paquebot Ā», se trouve au pied de              MarĆ­timo. Las paredes en su interior
on the Museum’s third floor, before         la rue Polk. Il a Ć©tĆ© construit comme                 estĆ”n decoradas con pinturas murales
it is returned to its main function as      un bain public en 1936, et aujourd’hui                fantĆ”sticas y coloridas. Aunque ahora
a visiting exhibitions gallery.             abrite le Musée maritime. Son intérieur               se halla en renovación, IAMFA podrÔ
                                            est dƩcorƩ de peintures murales fan-                  celebrar el banquete y la cena de gala
Runnymede Sculpture Farm                    tastiques et colorƩs. Bien que le musƩe               de la vigƩsima conferencia anual en el
Members and guests will visit Runny-        est actuellement en rĆ©novation, l’IAMFA               tercer piso del museo, antes de que
mede Sculpture Farm for a tour and          a la chance d’être en mesure d’accueillir             vuelva a su función normal de galerĆ­a
California BBQ.                             le dƮner de gala de son 20e ConfƩrence                para las exhibiciones prestadas de
                                            annuelle sur le troisième étage du                    otros museos.
Golden Gate Bridge                          MusĆ©e, avant qu’il ne soit retournĆ©
                                            Ć  sa principale fonction de galerie                   La Finca con esculturas
The Golden Gate Bridge was the long-
                                            d’exposition visitante.                               Runnymede
est suspension bridge in the world when
it was completed in 1937, and has be-                                                             Los miembros e invitados visitarƔn a
come one of the most internationally        La Grange aux sculptures                              la finca con esculturas Runnymede
recognized symbols of San Francisco,        Runnymede                                             para un paseo y una barbacoa de tipo
California, and the United States. Since    Les membres et leurs invitƩs se rendront              California.
its completion, the span’s length has       Ć  la Grange aux sculptures Runnymede
been surpassed by eight other bridges.      pour une visite et y profiter d’un                    El Puente Golden Gate
It still has the second-longest suspen-     barbecue Ć  la Californie.                             El Puente Golden Gate era el puente
sion bridge main span in the United                                                               suspendido mƔs largo del mundo
                                                                                        JOE MAY

States. It is estimated that about nine
million people from around the world
                                                                                                                                             JOE MAY

visit the Bridge each year.

The San Francisco Maritime Museum.          Runnymede Sculpture Farm.                             The Golden Gate Bridge.

                                                                                                    PAPYRUS SUMMER–FALL 2010         21
Letterman Digital Arts Center                Le Pont Golden Gate                        cuando se terminó en 1937 y se ha
The Letterman Digital Arts Center seam-      Le Pont Golden Gate Ʃtait le plus long     convertido en uno de los sƭmbolos
lessly integrates motion picture, visual     pont suspendu du monde quand il a          mƔs reconocidos de San Francisco,
effects and gaming technologies on one       ƩtƩ achevƩ en 1937, et il est devenu       California y de los EEUU. Luego de su
world-class digital arts campus. The 23-     l’un des symboles les plus reconnus        terminación, ocho puentes alrededor
acre campus is the new San Francisco         internationalement de San Francisco,       del mundo le han superado en largo,
home of Lucasfilm Ltd., bringing             en Californie et aux Ɖtats-Unis. Depuis    pero solo uno dentro de los EEUU
together Industrial Light & Magic,           son achèvement, la longueur de la          en cuanto a su tramo en suspensión.
LucasArts and Lucasfilm’s corporate          travĆ©e a Ć©tĆ© dĆ©passĆ©e par huit autres      Se estima que mĆ”s de 9 millones de
activities for the first time in the         ponts du monde. Mais aux Etats-Unis, il    visitantes acuden al puente desde
company’s nearly 40-year history.            dĆ©tient la deuxiĆØme place par la taille    diferentes puntos del mundo cada aƱo.
                                             de la portƩe suspendue. On estime que
Sir Francis Drake Hotel                      prĆØs de neuf millions de personnes         El Centro de Artes Digitales
Few hotels in the country are as synony-     de partout le monde entier visitent le     Letterman
mous with the city they call home as         pont chaque annƩe.                         El Centro de Artes Digitales Letterman
the Sir Francis Drake Hotel. Known by                                                   integra sin dificultad las tecnologĆ­as
locals as ā€œThe Drakeā€, the hotel defines     Le Centre des arts digitaux                de pelĆ­culas, de efectos visuales espe-
San Francisco: exciting, romantic, and       Letterman                                  ciales, y de juegos de video en un solo
a little offbeat. Take in the ornate lobby   Le Centre d’arts digitaux Letterman        campus de artes digitales de calidad
and the romantic clang of the cable          intègre de façon transparente le cinéma,   mundial. El campus de 23 acres es el
cars—it’s all part of the legendary          les effets visuels et les technologies     nuevo hogar de Lucasfilm Ltd., el cual
San Francisco experience. When this          de jeu sur un campus de classe mon-        consolida las actividades corporativas
historic hotel opened its doors in 1928,     diale des arts numƩriques. Le campus       de Industrial Light & Magic, LucasArts
the city had never seen anything like        de 23 acres est la nouvelle maison         y Lucasfilm por primera vez desde que
it. Although the city boasted a number       à San Francisco de Lucasfilm Ltd,          se fundó la compañía hace 40 años.
of luxury hotels, the Sir Francis Drake      rƩunissant Industrial Light & Magic,
Hotel was something else entirely: a         LucasArts et les activitƩs de la sociƩtƩ   El Hotel Sir Francis Drake
sleek state-of-the-art marvel reflecting     Lucasfilm pour la premiĆØre fois dans       Pocos hoteles en el paĆ­s tienen una
the dynamic spirit of a new metropolis       une entreprise de prĆØs de 40 ans           imagen tan representativa de la ciudad
emerging from the devastating 1906           d’histoire.                                en que se ubican como el Hotel Sir
earthquake.                                                                             Francis Drake. Conocido por los resi-
    The Starlight Room is located on         L’HĆ“tel Sir Francis Drake                  dentes locales como ā€œThe Drakeā€, el
the 21st floor of the Sir Francis Drake      Peu d’hĆ“tels dans le pays peuvent ĆŖtre     hotel define a San Francisco; emocio-
Hotel in San Francisco, location of the      considƩrƩs le synonyme de la ville         nante, romƔntico y un poco excƩntrico.
opening ceremonies for the twentieth         qu’ils appellent maison comme le fait      Observen el vestĆ­bulo ornamentada y
annual IAMFA conference.                     l’HĆ“tel Sir Francis Drake. Connu par       los estruendos de los tranvĆ­as—todo
                                                                                        es parte de la experiencia legendaria
State Railroad Museum                                                                   de San Francisco. Cuando este hotel
Located in Old Sacramento, the                                                          abrió sus puertas en 1928, la ciudad
California State Railroad Museum is                                                     nunca habĆ­a visto nada parecido.
a complex of historical facilities and                                                  Aunque la ciudad ofrece varios hoteles
unique attractions. Widely regarded as                                                  de lujo, el Hotel Sir Francis Drake
North America’s most popular railroad                                                   es algo completamente diferente: un
museum, there is something here for                                                     hotel elegante con toda la tecnologĆ­a
everyone, including lavishly restored                                                   mƔs corriente que refleja el espƭritu
                                                                                        dinÔmico de una nueva metrópolis
                                                                                        que emergió del terremoto devastador
                                                                                        de 1906.

The Letterman Digital Arts Center.           The Sir Francis Drake Hotel.               The Starlight Room.

22     PAPYRUS SUMMER–FALL 2010
trains, engaging exhibits, and unique       les habitants comme Ā« Le Drake Ā»,                El Salon ā€œStarlightā€ se ubica en
special events.                             l’hĆ“tel dĆ©finit San Francisco: passion-       el vigĆ©simo primer piso del Hotel
                                            nante, romantique, et un peu dƩcalƩ.          Sir Francis Drake, el lugar de la cere-
Crocker Art Museum                          Profiter du superbe salon et des roman-       monia de apertura de la vigƩsima
The Crocker Art Museum in Sacramento        tiques tintements des sons mƩtalliques        conferencia anual de IAMFA.
has embarked on the most monumen-           des câble-voitures qui font tous partie de
tal endeavor in its 125-year history. An    l’expĆ©rience lĆ©gendaire de San Fran-          El Museo Estatal del Ferrocarril
expansion project is underway, not only     cisco. Lorsque cet hƓtel historique a         Ubicado en Viejo Sacramento, el
tripling the size of the current facility   ouvert ses portes en 1928, la ville n’avait   Museo Estatal del Ferrocarril es un
but spanning all facets of the organiza-    jamais rien vu de pareil. Bien que la ville   complejo de instalaciones históricas y
tion, from collection and endowment         comptait un certain nombre d’hĆ“tels           atracciones Ćŗnicas. Es considerado el
growth to enriching every aspect of the     de luxe, l’HĆ“tel Sir Francis Drake a          museo de ferrocarril de Norte AmĆ©rica
visitor experience. The new Crocker         ƩtƩ tout une autre chose: un Ʃtat mag-        mƔs popular, hay algo de interƩs para
Museum is set to open to the public         nifique et impeccable de l’art qui reflĆØte    todo el mundo, incluyendo trenes res-
on October 10, 2010.                        l’esprit dynamique d’une nouvelle             taurados con mucho esmero, exhibi-
                                            mƩtropole qui sort du dƩvastateur             ciones interesantes, y eventos especiales
State Capitol                               tremblement de terre de 1906.                 Ćŗnicos.
At the State Capitol in Sacramento, the        La salle Starlight est situƩe au 21e
past, present and future of California      Ć©tage de l’HĆ“tel Sir Francis Drake, Ć          El Museo de Arte Crocker
interact. The building serves as both       San Francisco, le lieu de la cƩrƩmonie        El Museo de Arte Crocker en Sacra-
a museum and as the state’s working         d’ouverture de la vingtiĆØme confĆ©rence        mento se ha embarcado en la obra
seat of government. Visitors to the         annuelle de l’IAMFA.                          mĆ”s monumental de su historia de
Capitol can experience California’s                                                       125 aƱos. Un proyecto de expansión
rich history, while also witnessing the     Le MusƩe du chemin de fer                     estƔ en progreso, que no solamente
making of history through the modern        de l’État                                     triplica el tamaƱo de su instalación
lawmaking process.                          SituƩ dans le Vieux Sacramento, le            actual sino que abarca todas las facetas
CONTINUED ON PAGE 26                        MusĆ©e du chemin de fer de l’État est un       de la organización, desde el crecimi-
                                            complexe d’installations historiques          ento de sus colecciones y de sus anfi-
                                            et des attractions uniques. ConsidƩrƩ         triones hasta el enriquecimiento de
                                            comme l’un des musĆ©es du chemin de            todos los aspectos de la experiencia de
                                            fer en AmƩrique du Nord les plus              los visitantes. El Museo Crocker estƔ
                                            populaires, il y a ici quelque chose          programado para abrir al pĆŗblico el
                                            pour tout le monde, y compris les             10 de octubre de 2010.
                                            trains somptueusement restaurƩs,
                                            l’engagement des expositions, des             El Capitolio del Estado
                                            ƩvƩnements spƩciaux et uniques.               El pasado, el presente, y el futuro
                                                                                          de California se interactĆŗan en el
                                            Le MusĆ©e d’art Crocker                        Capitolio del Estado. El edificio sirve
                                            Le MusĆ©e d’art Crocker Ć  Sacramento           tanto de museo como de sede oficial del
                                            a lancĆ© l’entreprise la plus monumen-         gobierno. Los visitantes al Capitolio
                                            tale de son histoire de 125 ans. Un           pueden experimentar la historia rica de
                                            projet d’agrandissement est en cours,         California, mientras observan la cre-
The State Railroad Museum.                  non seulement triplant la taille de           ación de historia a través del moderno
                                            l’installation actuelle, mais couvrant        proceso de crear leyes.
                                                                                          SIGUE EN LA PƁGINA 26
                                            tous les aspects de l’organisation, de la
                                            collecte et la croissance de dotation
                                            jusqu’à l’enrichissement de tous les
                                            aspects de l’expĆ©rience du visiteur. Le
                                            nouveau Musée Crocker est prêt à
                                            ouvrir au public le 10 Octobre 2010.

                                            Le Capitol de l’État
                                            Au Capitole de l’État Ć  Sacramento,
                                            le passĆ©, le prĆ©sent et l’avenir de la
                                            Californie interagissent. Le bâtiment
                                            sert à la fois de musée et de siège de
The Crocker Art Museum.                     SUITE ƀ LA PAGE 26                            The State Capitol.

                                                                                             PAPYRUS SUMMER–FALL 2010         23
2010 IAMFA Con
                                                                           DELEGATE PROGRAM
                                                                                                                               SUNDAY, O
                                    8:00 am   Benchmarking Registration and Breakfast             Sir Francis Drake (SFD) Hotel, 450 Powell

                                   12:00 pm   Conference Registration and Bag Pickup for          Sir Francis Drake Hotel, Mezzanine
                                              Everyone                                            Lobby

                                    6:00 pm   Ice Breaker Reception and Welcome                   Harry Denton’s Starlight Room, SFD

                                                                                                                               MONDAY, O
                                    8:00 am   Travel to Breakfast at SFMOMA                       San Francisco Museum Of Modern Art

The new rooftop Garden at           9:30 am   Benchmarking Recap, LED Lighting Presentations,     SFMOMA’s Phyllis Wattis Theater
SFMOMA.                                       Tour

                                   11:30 am   Travel to Lunch at Stanford University              To Stanford Bing Wing Library

                                    1:30 pm   Tour and Seismic Presentation                       Stanford Libraries

                                    4:30 pm   Tour Cantor Art Center with Guests                  Cantor Art Center

                                    5:15 pm   Travel to Runnymede, Walking Sculpture Tour         Runnymede Sculpture Farm
                                              and BBQ

                                    8:30 pm   Travel to Hotel                                     To Sir Francis Drake Hotel

                                                                                                                               TUESDAY, O
The Stanford University campus.     8:00 am   Travel to Breakfast at De Young Museum              To Golden Gate Park

                                    9:30 am   IAMFA Master Planning Session, DeYoung              De Young Museum
                                              Presentation, Tour

                                   12:30 pm   Lunch in the Forum Facing the Shakespeare Garden    California Academy of Sciences

                                    2:00 pm   Green Historic Preservation, LEED Platinum Bldg.,   California Academy of Sciences
                                              Tours

                                    5:00 pm   Return to Hotel for Free Evening                    To Sir Francis Drake Hotel

                                    6:00 pm   Board Meeting                                       Sir Francis Drake Hotel

                                                                                                                            WEDNESDAY,
The deYoung Museum, open now
for nearly five years.              8:00 am   Travel to Breakfast, Annual Business Meeting        Contemporary Jewish Museum
                                              and Tour

                                   10:45 am   Innovation in the Exploratorium’s New Plans         Exploratorium
                                              and Tour

                                   12:30 pm   Lunch at Letterman Digital Arts Center              Letterman Digital Arts Center

                                    1:45 pm   Historic Preservation Award Winner and Tour         Walt Disney Family Museum

                                    3:30 pm   Walk across Golden Gate Bridge, W5                  From North toward City

                                    4:45 pm   Travel to Hotel, Dress for Gala Dinner              Sir Francis Drake Hotel

                                    6:00 pm   Group Photo and Wine, Gala Dinner                   Maritime Museum
The new LEED Platinum California
                                   10:00 pm   Bus back to Hotel
Academy of Sciences.
                                                                                       THURSDAY, OCTOBER 21 — ā€œA CAPITAL IDEAā€
                                    8:30 am   Day Tour to Sacramento                              Bus Departs SFD

                                    9:30 am   Benicia for Coffee                                  Old State Capitol

                                   10:00 am   Travel onward and Facilities Tour                   State Railroad Museum

                                   12:00 pm   Lunch                                               Aboard Delta King

                                    1:30 pm   Tour Museum                                         Crocker Art Museum

                                    3:00 pm   Travel to Capitol for Tour                          Architectural Tour
The Exploratorium, a hands-on       5:00 pm   Drinks and Tour, Depart for Hotel at 6:00 pm        Historic Governor’s Mansion
experience for all who visit.

24     PAPYRUS SUMMER–FALL 2010
ference Schedule
                                         GUEST PROGRAM
CTOBER 17

 12:00 pm   Conference Registration and Bag Pickup for            Sir Francis Drake (SFD) Hotel,
            Everyone                                              Mezzanine Lobby

  6:00 pm   Ice Breaker Reception and Welcome                     Harry Denton Starlight Room, SFD

CTOBER 18
  8:00 am   Travel to Breakfast in the Garden Court               Palace Hotel

  9:30 am   Narrated SF Walking Tour—Ends at SFMOMA               Downtown                                The Garden Court at the famous
                                                                                                          Palace Hotel.
 11:30 am   Travel to Lunch at Stanford with Delegates            To Stanford Bing Wing Library

  1:30 pm   Shop, Stroll, Meander                                 Downtown Palo Alto

  4:30 pm   Join Delegates on Docent tour of Cantor Art Center    Cantor Art Center

  5:15 pm   Travel to Runnymede, Walking Sculpture Tour           Runnymede Sculpture Farm
            and BBQ

  8:30 pm   Travel to Hotel                                       To Sir Francis Drake Hotel

CTOBER 19
  8:30 am   Head for the Napa Valley                              Bus Transfer with Snacks on Board       One of many sculptures at
 10:00 am   Champagne and Light Picnic on the Terrace             Gloria Ferrer                           Runnymede Farm.

 11:30 am   Transfer to Lunch/Wine Pairing and Tour               Nicholson Ranch

  3:30 pm   Transfer to Hess Collection Tour and Tasting          The Hess Collection

  5:30 pm   Return to Hotel                                        To Sir Francis Drake Hotel

  7:00 pm   Free Evening

OCTOBER 20
  8:30 am   Light Tea Breakfast                                   Near Hotel                              The Golden Gate Bridge.

  9:30 am   Walk/Bus Transfer to Chinatown                        Chinatown

 10:00 am   Explore Chinatown with Author Shirley Torres          Chinatown

  1:30 pm   Travel to Disney Family Museum for Tour               Walt Disney Family Museum

  3:30 pm   Walk across Golden Gate Bridge, W5                    From North toward City

  4:45 pm   Travel to Hotel, Dress for Gala Dinner                Sir Francis Drake Hotel

  6:00 pm   Group Photo and Wine, Gala Dinner                     Maritime Museum
                                                                                                          The vineyards at Gloria Ferrer
 10:00 pm   Bus back to Hotel                                                                             winery.
— EXTRA DAY TOUR (Additional Cost of $75)

                                    See Delegate Schedule for Sacramento

                                                                                                          Wine-tasting at The Hess Collection
                                                                                                          winery, located atop Mount Veeder.

                                                                                                      PAPYRUS SUMMER–FALL 2010         25
THE TWENTIETH ANNUAL IAMFA CONFERENCE      LA VINGTIƈME CONFƉRENCE DE L’IAMFA           LA VIGƉSIMA CONFERENCIA ANUAL DE IAMFA
CONTINUED FROM PAGE 23                     SUITE DE LA PAGE 23                          VIENE DE LA PƁGINA 23

Historic Governor’s Mansion                travail du gouvernement de l’État. Les       La Mansión histórica del
California’s executive mansion, pop-       visiteurs du Capitole peuvent connaĆ®tre      Gobernador
ularly known as the Governor’s             la riche histoire de la Californie, tandis   La Mansión Ejecutiva de California,
Mansion, was built in 1877 for Albert      qu’ils assistent aussi Ć  la rĆ©alisation      conocida popularmente como la
and Clemenza Gallatin. Albert was a        de l’histoire Ć  travers du moderne           Mansión del Gobernador, fue con-
partner in the Sacramento hardware         processus lƩgislatif.                        struida en 1877 por Albert y Clemenza
store of Huntington & Hopkins. The                                                      Gallatin. Albert era socio en la ferre-
State of California purchased the house    La Masion historique du                      terĆ­a de Huntington & Hopkins, en
from Joseph and Louisa Steffens to         Gouverneur                                   Sacramento. El estado de California
use as a home for California’s first       La Maison executive de la Californie,        compró esta casa a Joseph y Louisa
families in 1903 for $32,500.              populairement connu comme la Maison          Steffens para usarla como un hogar
                                           du Gouverneur, a ƩtƩ construite en           para las primeras familias de
                                           1877 pour Albert et Clemenza Gallatin.       California en 1903 por $32,500.
                                           Albert Ʃtait partenaire de la quin-
Guests of IAMFA members attending
                                           caillerie Huntington & Hopkins, Ć
the conference this year will have their
                                           Sacramento. L’État de la Californie
own agenda as usual, offering an expe-
                                           acheta la maison Ć  Joseph et Louisa          Los invitados de los miembros de
rience of San Francisco that they won’t
                                           Steffens pour l’utiliser comme un            IAMFA que asisten a la conferencia
soon forget. Guest activities include:
                                           foyer pour les premières familles de         este año tendrÔn también su propio
• Breakfast at the Palace Hotel            la Californie en 1903, pour 32 500 $.        itinerario como de costumbre, que les
                                                                                        ofrece una experiencia de San Francisco
• Tour of the Walt Disney Family
                                                                                        que no se olvidarƔn pronto. Las
  Museum (Delegates and Guests)
                                                                                        actividades de los invitados incluirƔn:
• Walk across Golden Gate Bridge           Les invitĆ©s des membres d’IAMFA
  toward San Francisco (Delegates                                                       • un desayuno en el Hotel Palace
                                           assistant Ơ la confƩrence de cette
  and Guests)                                                                             una gira al Museo de la Familia de
                                           annƩe auront leur propre ordre du
                                                                                          Walt Disney (delegados e invitados)
• Annual Gala Banquet at the               jour comme d’habitude, offrant une
  Maritime Museum (Delegates               expĆ©rience de San Francisco qu’ils           • un paseo por el Puente Golden Gate
  and Guests)                              n’oublieront pas de sitĆ“t. Ces activitĆ©s       hacia San Francisco (delegados e
                                           comprennent:                                   invitados)
• Tour of Runnymede Sculpture Farm
  plus California BBQ (Delegates and       • Petit dĆ©jeuner Ć  l’HĆ“tel Palace            • cena y fiesta de gala en el Museo
  Guests)                                                                                 MarĆ­timo (delegados e invitados)
                                           • Visite guidĆ©e du MusĆ©e de famille
• Champagne and Light Picnic on              de Disney Walt (dĆ©lĆ©guĆ©s et invitĆ©s)       • una gira a la Finca con esculturas
  the Terrace of Gloria Ferrer Winery                                                     Runnymede y una barbacoa estilo
                                           • Traverser le Pont Golden Gate vers           California (delegados e invitados)
  in Napa Valley
                                             San Francisco (dƩlƩguƩs et invitƩs)
• Interactive Lunch and Wine                                                            • champaƱa y una merienda liviana
  Pairing and Tour at Nicholson            • Le banquet de gala annuel au MusĆ©e           en la terraza del viƱedo de Gloria
  Ranch in Napa Valley                       maritime (dƩlƩguƩs et invitƩs)               Ferrer en el valle de Napa
• Hess Collection Tour and Tasting         • Tour de la Grange aux sculptures           • una merienda interactiva y guĆ­a de
  in Napa Valley                             Runnymede plus le barbecue Ć  la              combinar vinos con una gira en el
                                             Californie (dƩlƩguƩs et invitƩs)             rancho Nicholson del valle de Napa
                                           • Pique-nique Champagne et LumiĆØre           • una gira de la colección Hess y
                                             sur la terrasse de la cave Gloria            degustación en el valle de Napa
                                             Ferrer dans la vallƩe de Napa Tour
                                                                                        • explorar el Barrio Chino con
                                           • Tour de la Collection Hess et                Shirley Fong-Torres, autor de The
                                             dƩgustation dans la vallƩe de Napa           Woman who Ate Chinatown (La Mujer
                                           • Explorer Chinatown (quartier                 que comió al Barrio Chino)
                                             chinois) avec Shirley Fong-Torres,         • paseo a pie narrado de San Francisco
                                             auteur de La femme qui mangea
                                             Chinatown (The Woman who Ate               • almuerzo en la Universidad de
The Governor’s Mansion.                      Chinatown)                                   Stanford (delegados e invitados)

26     PAPYRUS SUMMER–FALL 2010
• Explore Chinatown with Shirley           • Visite Ć  pied et commentĆ©e de            • salida de compras en el centro de
  Fong-Torres, author of The Woman           San Francisco                              Palo Alto
  who Ate Chinatown
                                           • DĆ©jeuner Ć  l’UniversitĆ© de Stanford      • gira con docentes del Centro
• Narrated San Francisco Walking             (dĆ©lĆ©guĆ©s et invitĆ©s)                      de Artes Cantor (delegados y
  Tour                                                                                  invitados)
                                           • Les Grands magasins au centre-ville
• Lunch at Stanford University               de Palo Alto                             • visita a las instalaciones del Museo
  (Delegates and Guests)                                                                del Ferrocarril Estatal (jueves—
                                           • Tour d’enseignants au Centre
                                                                                        delegados e invitados)
• Shopping Spree in Downtown                 d’arts Cantor (dĆ©lĆ©guĆ©s et invitĆ©s)
  Palo Alto                                                                           • gira del Museo de Arte Crocker
                                           • Visite des installations du MusĆ©e
                                                                                        (jueves—delegados e invitados)
• Docent tour of Cantor Arts Center          du chemin de fer de l’Etat (jeudi –
  (Delegates and Guests)                     dĆ©lĆ©guĆ©s et invitĆ©s)                     • gira al Capitolio del Estado con
                                                                                        Ć©nfasis en la arquitectura (jueves—
• Visit State Railroad Museum for          • Tour au MusĆ©e d’art Crocker (jeudi –
                                                                                        delegados e invitados)
  Facilities Tour (Thursday—Delegates        dĆ©lĆ©guĆ©s et invitĆ©s)
  and Guests)                                                                         • visita a la histórica Mansión del
                                           • Visite architecturale du Capitol
                                                                                        Gobernador (jueves—delegados e
• Crocker Art Museum Tour                    (jeudi – dĆ©lĆ©guĆ©s et invitĆ©s)
                                                                                        invitados)
  (Thursday—Delegates and Guests)
                                           • Tour Ć  la Maison historique du
• State Capitol Architectural Tour           Gouverneur (jeudi – dĆ©lĆ©guĆ©s et             Deseamos darle la bienvenida a
  (Thursday—Delegates and Guests)            invitĆ©s)                                 todos los miembros de IAMFA y sus
                                                                                      invitados a San Francisco. Por favor
• Historic Governor’s Mansion Tour
                                               Nous sommes impatients d’accueillir    consulten www.IAMFA.org, y regĆ­strense
  (Thursday—Delegates and Guests)
                                           tous les membres de l’IAMFAet leurs        antes del 17 de agosto para conseguir
                                           invitĆ©s Ć  San Francisco. S’il vous plaĆ®t   el descuento de registro temprano.
   We are eager to welcome all IAMFA
                                           voir www.IAMFA.org et inscrivez-vous       Por favor llamen a 800-795-7129 y
members and their guests to San Fran-
                                           avant le 17 aoƻt pour obtenir le rabais    mencionen a la conferencia anual de
cisco. Please see www.IAMFA.org, and
                                           pour toute inscription. S’il vous plaĆ®t    IAMFA para reservar su cuarto en el
register before August 17 to get the
                                           appelez Ʃgalement 800-795-7129 et          Hotel Sir Francis Drake. Hay un precio
early registration discount. Please also
                                           mentionnez la ConfƩrence annuelle de       negociado por cuarto de $169 por
call 800-795-7129 and mention the
                                           l’IAMFA pour rĆ©server votre chambre        noche para un cuarto ā€œKing Deluxeā€,
IAMFA annual conference to reserve
                                           Ć  l’HĆ“tel Sir Francis Drake. Il y a un     pero por favor no esperen hasta el
your room at the Sir Francis Drake
                                           frais négocié de 169 $ par nuit pour       último momento para reservar su
Hotel. There is a negotiated room rate
                                           une chambre King Deluxe, mais nous         cuarto, para evitar que excedamos
of $169 per night for a King Deluxe
                                           vous prions de ne pas attendre la          nuestro bloque de cuartos.
room, but please do not wait until the
                                           dernière minute pour réserver votre
last minute to reserve your room; we
                                           chambre; nous pourrions dépasser le        ”Nos vemos en San Francisco!
could exceed the room block.
                                           bloc de chambres.                          El Equipo de la Conferencia
See You in San Francisco!
                                           Voyez-nous Ć  San Francisco!
The Conference Team
                                           L’équipe de la ConfĆ©rence

                                 Become a Member of IAMFA
                                     For more information on becoming a member of the
                           International Association of Museum Facility Administrators, please visit
                                                            WWW.IAMFA.ORG
                                                                          or
                                            See page 34 for details and enrollment form

                                                                                        PAPYRUS SUMMER–FALL 2010            27
The National Gallery
Casting New Light on Old Masters
By Steve Vandyke

L
      ondon’s National Gallery is now
      better equipped to present its Old
      Masters in the best possible light—
quite literally. Through the employ-
ment of Andrew Reid & Partners and
its own Trend Building Management
System (BMS), the National Gallery’s
Technical Services department has
developed and begun implementing
a new strategy for controlling gallery
roof blinds. This new system will allow
the collections to be viewed in natural
lighting for longer periods, whilst still
protecting them from direct sunlight.
In addition to enhancing the viewer’s
appreciation of a painting, the use of
daylight to provide illumination reduces
the need for artificial lighting, thus
saving energy.
    The Trend BMS provides close con-
trol and monitoring of environmental
                                              The National Gallery as seen from Trafalgar Square.
conditions throughout the National
Gallery’s main building. In doing so,
it plays a vital role in preserving the          When modulating the motorized                   The BMS also incorporates an exter-
Gallery’s priceless collection of Western     blinds to achieve set-points for light          nal lux sensor that shows whether it is
European paintings from the thirteenth        levels, the controllers must ensure             sunny or overcast. When it is overcast,
through nineteenth centuries, includ-         that no direct sunlight is admitted. In         the output from the max/min angle
ing masterpieces from virtually all the       most galleries, there was previously just       algorithm is overridden, and the blinds
great artists. Most of the building’s         a maximum opening angle for each sea-           can move to their fully open position.
40-plus galleries have glazed roofs,          son of the year, with no account taken          This also happens if the program
and here the system regulates the             of the Sun’s movement during the day.           determines that the roof light will be
light levels through coordinated              As a consequence, blinds were often             in shadow from an adjacent building
control of picture lighting and the           not opened as far as they could have            or another part of the roof structure.
rooflight window blinds.                      been, which unnecessarily restricted            Since the blinds need to be closed
    The galleries’ individual Trend IQ        the amount of natural light allowed             during the hours of darkness, the
controllers will only switch on the arti-     into the galleries.                             program also calculates the hours
ficial lighting if the optimal illumina-         The new blind-control program                of sunset and sunrise.
tion level cannot be achieved with            overcomes this limitation by using the             Light levels in each gallery are mea-
natural light alone, through control          time and date to continually calculate          sured by several sensors, and the gallery
of the blinds. Generally, a gallery has a     the changing position of the Sun. From          controller works from an average of
three-circuit lighting track: one com-        this, it repeatedly computes maximum            readings taken over the previous min-
prising blue lights simulating daylight,      and minimum safe opening limits for             ute. It also reacts to high or low instan-
and another made up of conventional           each set of blinds, taking into account         taneous values, by disabling or enabling
clear lamps. The first come on if the         their orientation and slope. The limits         the artificial lighting. In addition, it uses
average light level falls to a preset value   for each set are updated in rotation            these values to calculate cumulative
and, if this is not sufficient, the second    every two to three minutes. Calculations        light exposure levels, which should
set is switched on as well. The third         are made to a resolution of less than 1°,       not exceed 12,500 lux-hours per week.
circuit is used for after-hours patrol        although blind movements are made                  Ideally, the pictures are displayed
lighting.                                     in increments of 2.5° or 5°.                    with daylight to an average of 200 lux.

28     PAPYRUS SUMMER–FALL 2010
The motorized external blinds are                This can be summarized as follows:        XNC controller, which has sufficient
controlled via the BMS to ensure the                                                       software capacity to carry out the exten-
                                              • If daylight drops below 150 lux, the
light level is between 150 to 210 lux. If                                                  sive trigonometric calculations. This com-
                                                blues turn on (1st stage).
daylight is insufficient, the blue lens                                                    municates with the galleries’ existing
light fittings are switched on to provide     • If the combined light level of day-        controllers via the BMS network.
an additional 60 lux. If the light level        light and blues drops below 150 lux,           The program, which was tested using
is still insufficient, the clear lens light     the clears turn on (2nd stage).            an architectural software package that
fittings provide a further 90 lux.            • If the light level exceeds 210 lux,        includes solar simulation, is initially
                                                the clears turn off first.                 being applied in seven galleries. It
                                                                                           is expected to be rolled out to the
                                              • If the light level continues to exceed     remainder later this year, which will
                                                210 lux, the blues turn off.               require the installation of a second
                                              • As a safety function, if light levels      IQ3xcite XNC controller. Together,
                                                exceed 350 lux, all picture lighting       the two controllers will calculate and
                                                is turned off.                             supply settings for around 100 sets of
                                                                                           blinds of varying design and orienta-
                                              • If light levels fall below 90 lux, then    tion. The energy savings that result
                                                both stages of lighting are turned on.     could be significant.
                                                                                               The first elements of the National
                                                 There are delays built into the strat-    Gallery’s Trend BMS were installed
                                              egy, in order to prevent the lighting        more than 20 years ago. Today, it incor-
                                              cycling on and off due to sudden             porates over 100 IQ controllers, all
                                              changes in light level, as might be          operating within a single fully inte-
                                              experienced on a bright sunny day            grated system. A number of graphics-
                                              with fast-moving clouds.                     based supervisors provide the Gallery
                                                 The new blind-control strategy was        engineering staff with access to control
                                              devised by building services consultant      settings and system-monitored data.
                                              Andrew Reid & Partners which, like
                                              Trend Control Systems Ltd., has worked       Steve Vandyke is Head of Technical Services
One of the galleries, employing both          with the National Gallery for many years.    at the National Gallery on Trafalgar Square

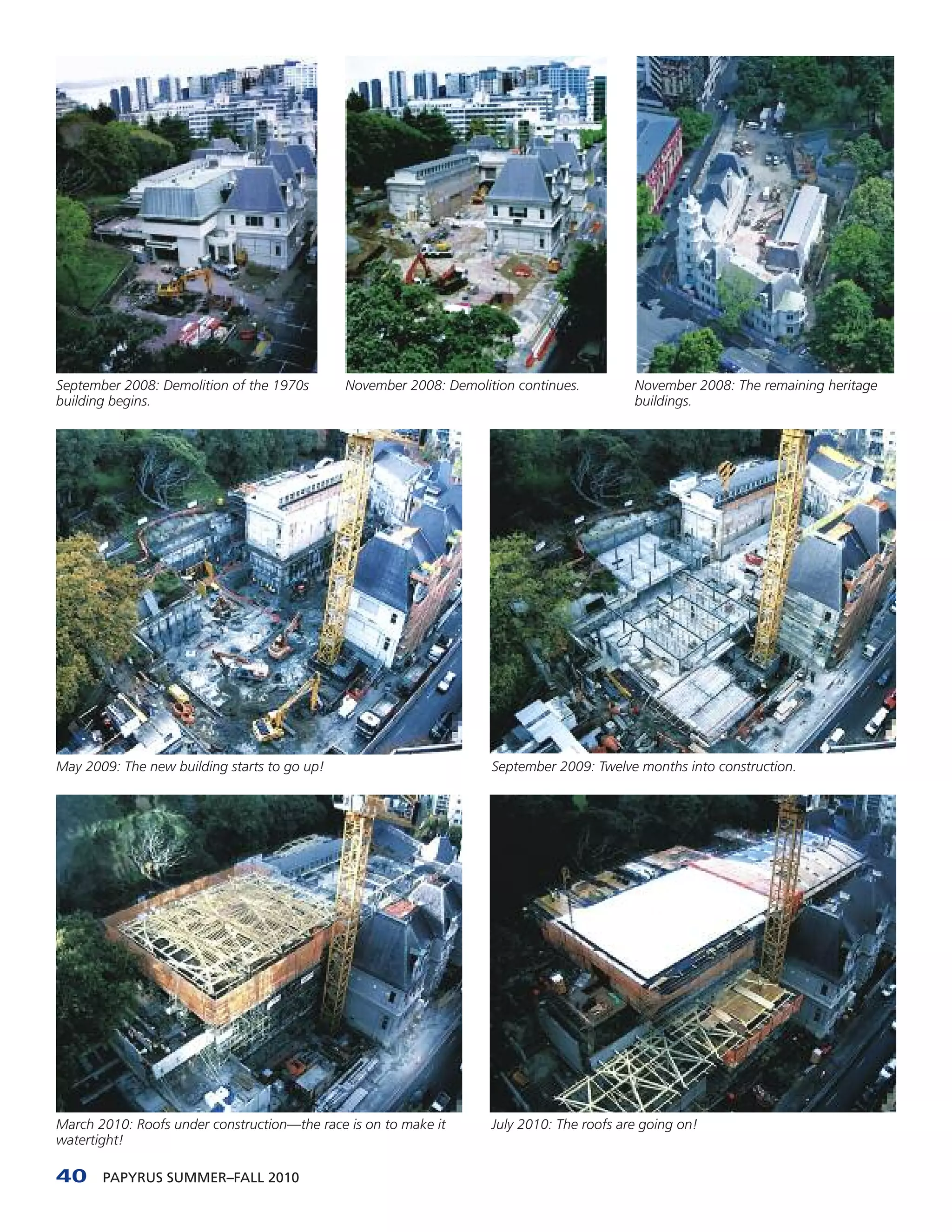

natural light and artificial illumination.    It has been installed into an IQ3xcite       in London.

MESSAGE FROM THE PRESIDENT                    MOT DU PRƉSIDENT                             MENSAJE DEL PRESIDENTE
CONTINUED FROM PAGE 4                         SUITE DE LA PAGE 4                           VIENE DE LA PƁGINA 4

institutions in order to reduce the num-      viduels; donc, je pense aussi qu’ils peu-    esta situación en sus propios paĆ­ses?
ber of separate museum bodies. Has            vent dƩcider que toutes les institutions     El Departamento de Cultura, Medios
anyone had experience of this in their        culturelles dans la ville fassent un appel   de Comunicación y Deporte del Reino
own countries? The UK Department of           d’offres commun pour les services des        Unido ha pedido detalles de las fechas
Culture, Media and Sport has requested        installations pour que, par exemple,         de terminación de nuestros contratos
details of all end dates of our indi-         il n’y ait qu’un contrat de nettoyage        individuales, asĆ­ que tambiĆ©n sospecho
vidual contracts, so I also suspect that      unique dans tous les musƩes et galeries.     que van a intentar que todas las insti-
they may try to make all the cultural         Est-ce que ceci est arrivĆ© Ć  l’un de nos     tuciones culturales de una ciudad
institutions within a city jointly tender     membres?                                     soliciten sus servicios de mantenimi-
their facility services—this might                Cette confĆ©rence sera l’occasion         ento juntos—para que tengamos, por
mean that we have, for instance, a            d’échanger des idĆ©es et de dĆ©velopper        ejemplo, un solo contrato de limpieza
single cleaning contract across all           un partenariat éducatif entre les            en todos los museos y galerías. ¿Han
museums and galleries. Has that               membres, ce qui nous permettrait             experimentado esta situación algunos
happened to any of our members?               de nous entraider et de partager des         de nuestros miembros?
   This conference will provide an            expƩriences. Donc, assurez-vous que             Esta conferencia nos brindarƔ la
opportunity to exchange ideas and             vous seriez lĆ  – mĆŖme si cela signifie       oportunidad de intercambiar ideas y
develop a learning partnership amongst        que vous deviez Ơ la considƩrer              desarrollar un equipo de aprendizaje
members, allowing us to help each other       comme temps de vacances!                     entre los miembros, que nos permita
and share experiences. So make sure                                                        ayudarnos y compartir experiencias.
you are there—even if it means you                                                         AsĆ­ que no falten—”aun si tienen que
have to treat it as vacation time!                                                         ocupar ese tiempo como vacaciones!

                                                                                              PAPYRUS SUMMER–FALL 2010           29
Facility Managers Lead
                                    the Move to Green with
                                    Improvements in Energy
                                    Efficiency
Thomas A. Westerkamp
                                    By Thomas A. Westerkamp

F
     acility managers are challenged to meet increasing               The best place to start documenting the power-distribution
     energy demands while holding the line on energy              system layout is at the incoming power service entrance. This
     costs. This article discusses key cost elements, load        is where the power company’s high-voltage service enters
profiling, sub-metering opportunities, links to other build-      your facility, passes through a high-voltage switch in your
ing management systems, energy efficiency checks, and             substation, then continues through a transformer where
training opportunities, as well as the rewards for successfully   the voltage is stepped down to the highest voltage distributed
meeting the difficult challenge of being green.                   in your facility—typically 440 volts. From the main switch
                                                                  gear, the power-distribution system branches out into feeder
                                                                  circuits. Typical groupings of power users are: boiler and
Load Profiling
                                                                  steam systems; building heating and cooling; compressed
Energy consumption in the U.S. has increased almost               air; data centers; hot water; lighting; plant operating equip-
without interruption for more than four decades, from             ment, motors and drives; refrigeration; and security systems
67.8 quadrillion BTU in 1970, to a peak of 101.5 quadrillion      and alarms. Each feeder may be divided into several branch
BTU in 2007 before the global recession—and even in               circuits, which provide electrical power to individual equip-
2009, was over 94 quadrillion BTU. Since the 1950s, U.S.          ment items such as HVAC air supply and exhaust drive
energy consumption has exceeded production. We are now            motors, lighting, heating devices, computer data centers,
dependent on foreign sources for over 20% of our energy.          and operating equipment. The layout should show each
   The energy users in your facility are the many standard        circuit and the equipment served, along with nameplate
and special equipment components arranged in a one-of-a-          information, such as volts, amps, horsepower, cycles, watts,
kind, unique physical layout, linked together by the power        design factor, and the like, for each equipment item.
distribution system. In many facilities, especially older ones,       As an alternative to preparing a blueprint schematic of
the exact arrangement is not well known, because the dis-         your power-distribution system, you can use a CAD system
tribution system blueprints or schematics have either been        software package—one that has electrical symbols in the
lost, or systems have been altered piecemeal over time with-      database, such as AutoCAD or Microsoft Visio—and create
out the alterations being documented each time. This is a         an up-to-date schematic using it (Figure 1). These tools have
very common, but nonetheless serious, disadvantage to             the distinct advantage of offering quick and easy revision.
facilities manager seeking opportunities for improvement:         Thus, if you add to the system or move equipment around
you have to know what you have before you can make it             as needs change, you have a much better chance of keeping
better and quantify benefits. Measurement must come               the layout up-to-date, because it is so much easier and quicker
before control.                                                   to do. The discipline of entering each field change when it
   Do you know where the top energy-users are located in          is implemented must be maintained by making this docu-
your facility, and how much energy they consume? Even if          mentation a mandatory part of the work order authorizing
you’re fairly confident about this, an annual energy check        the change.
may be in order to guard against creeping change. The first
step to start, or upgrade, an energy-monitoring system is

to get together all available system layout information. It       Power-Monitoring Equipment Reveals
is necessary to check all information by walking the system       that Measurement is Essential to Control
and marking up the old piping and electrical distribution         Power savings come from two sources: demand-rate reduc-
system schematics, noting additions and modifications. If         tion and lower energy consumption. Demand rate is the rate
you do not have the original drawings, there are standard         per kilowatt-hour (kw-hr) charged by the power company.
power-distribution system layout sheets, available from your      This rate is based on the peak demand that occurred during
electrical equipment vendor or your electric utility company      the period in which your rate was calculated. The higher
representative, which you can use to simplify the process         that peak demand was, and when it occurred, determines
and ensure that all key components are considered.                the rate you pay your electric utility company for all of your

30     PAPYRUS SUMMER–FALL 2010
power during the ensuing contract period. Energy consump-        sub-metering on each feeder circuit. These sub-meters will
tion is the cumulative kw-hrs consumed during the billing        show which feeders generate the greatest lighting, motor
period. The more kw-hrs consumed, the higher the bill.           and heating loads. Sub-metering individual branch loads
Both the rate and consumption are controllable expenses,         will identify the specific electrical equipment from which the
and the resulting energy cost can often be reduced by            most potential savings may be gained. An individual motor
20% with proactive power management, as opposed to low           load can be measured by simply clamping an ammeter, also
or no power management. Other benefits are shown in              called a tong tester, on each of the phases at the line switch.
Figure 2. Lowering your peak demand, or shifting your peak       By sorting the loads in descending order, you can create
demand away from the power company’s peak demand time            a Pareto analysis—for example, 80% of the load may be
of day, lowers your rate. Lowering consumption by installing     concentrated on 20% of the equipment—that highlights
more energy-efficient electrical devices—for example, replac-    the best savings opportunities.
ing incandescent with compact fluorescent lamps—also helps.         Energy consumers want to improve benefits from energy
So does cleaning fixtures and going back to lower-watt bulbs     consumption, reduce lifecycle costs, and keep the system
that were used before the fixtures got dirty.                    reliably consistent in providing a light-, temperature-, and
   The next step, after system documentation, is to upgrade      humidity-friendly environment for the art collections. Fac-
the power-monitoring program to evaluate the system you          tors you want the meters to identify are peak demand amount
have documented, and to assess opportunities. Where would        and time of day, the source of the greatest demands, and
monitoring likely provide the most benefit? The main service     disturbances that might cause critical interruptions, envi-
entrance switch gear is usually metered by the power com-        ronmental problems or power-quality problems. Power
pany—or in-house, if you generate your own power. These          meters basically measure volts and amps and convert the
sources provide a reading of the overall load, but don’t         readings internally to other metrics such as power factor: a
detail the individual loads that contribute to it. To obtain a   measure of the efficiency of the power delivered. The lower
breakdown, install some form of temporary or permanent           the power factor, the greater the losses (reactive kilovars),

                                                                            Lowering consumption has cost
                                                                            and other benefits:
                                                                            • Museums are showing their energy usage on
                                                                              a website dashboard to demonstrate tangible
                                                                              evidence of their contribution to a better
                                                                              environment.

                                                                            • The U.S. Energy Policy Act of 2005 (PL 109-58)
                                                                              provides tax deductions for design and instal-
                                                                              lation of energy-efficient commercial building
                                                                              systems, including lighting, heating, cooling,
                                                                              ventilating, hot water and building envelope
                                                                              systems.

                                                                            • The U.S. Energy Independence and Security
                                                                              Act of 2007, H.R. 6, calls for incandescent
                                                                              light bulb phase-out and replacement by
                                                                              more energy-efficient compact fluorescents,
                                                                              halogens, and LEDs. The phase-out, to be
                                                                              completed by 2020, could save $18 billion
                                                                              annually in electric bills in the U.S.

                                                                            • According to the U.S. Department of the
                                                                              Environment, converting to NEMA premium
                                                                              motors would save 5,800 gigawatts and
                                                                              prevent the release of 80 million metric
                                                                              tons of carbon into the atmosphere over
                                                                              ten years—or the equivalent of keeping
                                                                              16 million cars off the road.

Figure 1: Power distribution schematic.                                    Figure 2

                                                                                         PAPYRUS SUMMER–FALL 2010          31
and the more you pay for the same useful power. For                    If you have introduced new CAD electrical-distribution
example, induction motors tend to lower power factor,              software, now is a good time to broaden familiarity with it,
sometimes to as low as 80%. Induction motor circuit power          so that more than one person in the organization can update
factor is corrected toward unity (PF = 1, or 100%) by instal-      it or retrieve sections for planning purposes.
ling variable-power factor-correction capacitors in the circuit,       If you order new power-monitoring software and sub-
which automatically adjust power factor for that circuit load.     metering equipment for your upgraded system, it is very
Depending on the variations read by the meters, power factor       important to get complete sets of operating and maintenance
can be increased to the high 90s, saving a lot of energy and       manuals, including parts lists and preventive maintenance
at the same time reducing the peak demand, if related              plans, in sufficient copies. To ensure this, list these items
equipment is the cause of the peak demand. This adjust-            in the purchase order specification as a separate line item.
ment, therefore, has the potential to save both the total          After the order is placed, it may be very hard to go back and
amount used and the rate paid.                                     get the missing documentation. Specific vendor training is
   The same meters that detect peak demand and power               another important line item in your specification. Every-
factor can be used to track disturbances and energy cost           one has had the experience of the vendor coming in for
by department, tenant, process or output. They can also            a day or two, when the software and equipment are new,
provide 24/7 load profiles, and automate load control and          to provide some training—but some of the features may
load management. By tying the system into your building            not be used for quite a while. When the maintenance folks
automation system (BAS), you can more easily monitor               attempt to use those features later, they often find that they
both systems. If the construction specifications included          have forgotten the training.
interoperability standards such as BACNet (ASHRAE’s                    To prevent this, and to get the most from vendor training
interoperability process standard), you can integrate several      offerings, smart managers have the training done in at least
systems spread over one or more buildings, campuses, or            two phases. The first phase is introductory training that rep-
states, so that all systems—and the total energy consumption       resents a first contact with the new material. It includes an
of all facilities—can be monitored from one central point.         overview of the whole system and detailed training by example
   Meters have integrators that store readings, so that in         on the features that will be used first. Each trainee should
the event of a power interruption, you don’t lose any data.        have plenty of hands-on practice with the new equipment
When power returns, the stored data is accessed and logged.        at this point.
                                                                       Between the first and second training sessions—perhaps
Software Opportunities                                             a month or so apart—each trainee should keep a notebook
                                                                   and log any problems, glitches and things they don’t under-
Power-management meters and sub-meters comprise the
                                                                   stand. Of course, if the new equipment includes some fairly
system hardware. Coupled with the software, you have a
                                                                   high-tech features, you’ll want to add a service agreement
powerful energy-data collection, management and control
                                                                   to the bill of material, so that you can get online or telecom
system. Each meter represents a measurement and control
                                                                   help when you need it for urgent problems that cannot wait
point. The data from that point is fed back to the computer,
                                                                   for a second round of training.
converted into the various metrics you are measuring, and
                                                                       The second training session—and other future sessions—
is displayed on a real-time graphic display at one or several
                                                                   review the entire system, with concentration on the features
control points. The graphic shows your power-distribution
                                                                   that are most important in your installation. Sometimes it
system. Each control point is represented symbolically and,
                                                                   is hard to get the vendor to depart from a canned training
next to the symbol, a data display box registers the real-time
                                                                   program. Their instructors are taught specific course
variation in kilowatts at that point, as well as other metrics
                                                                   content, and are often not prepared to depart from it in
that you have selected. The meters are scalable, so you can
                                                                   order to resolve your specific problems. It is good to know
add more metrics and read them at more or less frequent
                                                                   this ahead of time, and make your interest in site-specific
intervals as required.
                                                                   training known in advance, to avoid unrealistic expecta-
                                                                   tions and disappointments, and ensure that the training
Systems Training Needs                                             does meet your needs.
Having completed the specification for power-distribution              Energy conservation spans all building systems, structural,
upgrades and monitoring, that spec list is also your list          mechanical and electrical. An energy-efficiency check can
of very important training opportunities. You can use the          reveal many opportunities for tuning up your facility. A
updated schematic to bring all the electricians and elec-          checklist of items that influence energy efficiency is shown
tronic technicians who work on the system up-to-date on            in Figure 3. Facility managers can use this list as a starting
the current layout, and point out the current load-balance         point to focus their energy-improvement efforts. Each faci-
situation: where there are bottlenecks in the capacity that        lity is unique, and will have other opportunities that can be
limit further loads on that phase, feeder or branch, and           added to customize the list. Repeated annually, this energy-
where further loads are okay. You can also begin, just by          efficiency improvement check will provide details that help
inspection of the load distribution, to make improvements          to prioritize your continuous improvement efforts.
to reduce the load—such as premium efficiency motors                   A coherent energy strategy, based on detailed knowledge
and low-wattage lamps replacing older less-efficient ones.         about your energy load and rate basis will ensure that your

32     PAPYRUS SUMMER–FALL 2010
facility finds it easier and more eco-
nomical being green. You will achieve       Energy Efficiency Improvement Checklist
all of your energy conservation objec-                                                     ā–” Refrigeration system lines/valves properly
                                            Boilers, Steam and Electric
tives: reducing consumption, preserving                                                      insulated
                                            Generation
resources, reducing pollution, and          ā–” Time, temperature, turbulence and            ā–” Ice storage used for peak-demand
lowering lifecycle costs. There is also        oxygen balanced for optimum efficiency        optimization
a public relations benefit in keeping       ā–” Cogeneration to optimize fuel use            ā–” Pumps/motors/blowers/drives checked
employees and visitors aware of your                                                         with vibration analysis
                                            ā–” Steam/electric load vs. capacity balance
good stewardship.                              optimized                                   ā–” Belt drives are tightened, belts replaced
                                                                                             per annual schedule
                                            ā–” Boiler feedwater treatment optimized
                                                                                           ā–” Water sub-metering used to optimize
Tom Westerkamp is President, Work           ā–” Annual tube check/cleaning, boiler
                                                                                             water use
Management Division of the Westerkamp          re-insulation completed on schedule
                                                                                           ā–” Hot water temperature set optimally
Group, LLC. He is a consultant, speaker,    ā–” Annual pressure relief valve
author, co-founder and former CEO of           checks/rebuilds per schedule                ā–” Hot water tanks/lines insulated
Productivity Network Innovations, LLC.      ā–” Steam pressure optimized/no leaks            ā–” Water heaters off when not needed
His book, Maintenance Manager’s             ā–” Economizers optimizing heat recovery         ā–” Special purpose areas; e.g., kitchen, lab,
Standard Manual, 3rd Edition, 2007, is                                                       cold storage optimized for HVAC and
                                            ā–” Boiler blowdown timing/amount as
distributed by BNi Books, Vista, CA. The                                                     R control
4th Edition is scheduled for publication       recommended
in Fall 2010. He can be reached at          ā–” Steam/condensate piping insulation
                                                                                           Compressed Air
tawest@westerkampgroup.com.                    inspected/repaired annually                 ā–” Compressor cycling optimized per baseline
                                            ā–” Condensate return recovery %
                                                                                           ā–” Lines and valves checked, and leaks fixed
                                            ā–” Traps/strainers cleaned/checked
                                                                                           ā–” Pressure regulators/filters/oilers
                                            ā–” Condenser tubes cleaned per annual             cleaned/checked per schedule
 Other Resources                               schedule                                    ā–” Condensate blowdowns completed per
                                            ā–” Electrical distribution/contacts checked       schedule
 • American Society of Heating,
                                               with thermal imaging and cleaned
   Refrigeration, and Air Conditioning                                                     ā–” Air tools cleaned, no line leaks, and
                                               annually
   Engineers (ASHRAE)                                                                        operating efficiently
                                            ā–” Motors blown out per schedule
   www.ashrae.com                                                                          ā–” Multi-compressor systems cycling most
                                            ā–” Premium motors used                            efficiently
 • EPA Energy Star ā€œGuidelines              ā–” Power factor optimized by metering and
   for Energy Managementā€                      adjustable capacitors                       Lighting
   www.epa.gov                              ā–” Sub-metering employed to identify high       ā–” Lighting levels optimal for space use

 • Institute of Electrical and                 energy areas                                  per standards
   Electronic Engineers (IEEE)              ā–” Net-metering sell-back program used to       ā–” Replace incandescent with compact

   3 Park Avenue, 17th Floor                   optimize energy costs                         fluorescent lamps
   New York, NY 10016                       ā–” gram used to optimize energy costs           ā–” Clean fixtures for high efficiency per

   212-419-7555                                                                              annual schedule
   www.ieee.org                             Building Heating, Ventilating and              ā–” Optimal use of natural light, occupancy
                                            Air Conditioning                                 sensors
 • International Association of                                                            ā–” High-efficiency lamps used in high-bay
                                            ā–” Insulation adequate
   Electrical Inspectors (IAEI)                                                              areas
                                            ā–” Window/door seals working
   P.O. Box 830848                                                                         ā–” Wall/ceiling coatings optimize reflectance
   Richardson, TX, 75083-0848               ā–” Proper air supply/exhaust balance
   972-235-1455,                            ā–” Proper air-volume change rate                Other
   www.iaei.com                             ā–” Proper thermostat settings used              ā–” Facility-wide annual lube program
                                            ā–” Building automation-systems controls           optimizes lube quality/quantity/frequency
 • National Rural Electric Co-op
   Association (NRECA)                         resets                                      ā–” Annual PM/PdM system coverage and
                                            ā–” Proper filter maintenance scheduled            schedule compliance >95%
   4301 Wilson Blvd.
   Arlington, VA 22203                         annually                                    ā–” Total lifecycle management practiced.
                                            ā–” Sunny-side window shades closed                Compare alternative purchases using
   703-907-5500
                                                                                             Lifecycle Cost Analysis
   www.nreca.org                            ā–” Zones/heating/cooling not competing
                                                                                           ā–” Investigate renewable energy sources;
                                            ā–” Economizers returning seasonal hot/cold
 • U. S. Department of Energy                                                                e.g., solar
                                               air temperature
   www.doe.gov                                                                             ā–” Your facility-specific checkpoints:
                                            ā–” Use of variable air volume, variable-speed
 • Westerkamp, Thomas A.,                      drives instead of dampers                     ā–” ——————————————————
   Maintenance Manager’s Standard           ā–” Peak-demand reduction opportunities            ā–” ——————————————————
     Manual                                    checked annually
                                                                                             ā–” ——————————————————
   3rd Edition                              ā–” Chilled water system operating efficiently
   BNi Publications, 2007                                                                    ā–” ——————————————————
                                            ā–” Cooling towers/spray nozzles cleaned
   www.pninc.com                               per annual schedule                           ā–” ——————————————————

                                           Figure 3

                                                                                              PAPYRUS SUMMER–FALL 2010                33
Become a Member of IAMFA
And get a friend to join
On behalf of the membership and Board, we invite you                  Membership Opportunities
to join with other museums and cultural organizations                 Join the IAMFA at any of the following levels and enjoy
throughout the world in becoming a member of the only                 full benefits of membership:
organization exclusively devoted to museum and cultural
facility administrators: the International Association of             Regular Member — $150 annually. A regular member
Museum Facility Administrators (IAMFA). As a member,                  holds the position of principal administration in direct
you will join a growing list of museum and cultural facility          charge of the management of facilities, and represents
administrators in their efforts to provide a standard of              their institution(s) as a member of the association.
excellence and quality in planning, development and design,           Associate Member — $50 annually. An associate member is
construction, operation and maintenance of cultural                   a full-time facilities management employee (professional,
facilities of all sizes and varieties of programming.                 administrative or supervisor), below the level of the
The Association currently has representation in several               facility administrator of the member association.
countries on three continents. Our goal is to increase                Affiliate Member — $50 annually. An affiliate member is
membership in institutions throughout the world.                      any full-time employee of a member institution who is not
                                                                      directly involved in the facilities management department.
Your involvement in IAMFA will continue the growth
of the organization and provide you with excellent                    Retired Member — $50 annually. A retired member is
educational and networking opportunities. As your                     retired, and no longer involved in facilities management.
colleagues, we look forward to welcoming you to
                                                                      Subscribing Member — $300 annually. A subscribing
membership in IAMFA.
                                                                      member is an individual, organization, manufacturer of
Cordially yours,                                                      supplier of goods services to the institutions who ascribes
The Board of the International Association of Museum                  to the policies and programmes of the Association, and
Facility Administrators                                               wishes to support the activities of the Association.

                     Send in your membership dues by using the convenient form below.
         Membership payments and conference registration can also be made online at www.IAMFA.org
                              Don’t forget to make a copy to give to a colleague.

    Ā”
                  YES! I would like to join IAMFA as a:
                  ā…Ŗ Regular Member        $150          ā…Ŗ Retired Member            $ 50
                  ā…Ŗ Affiliate Member      $ 50          ā…Ŗ Subscribing Member        $300
                  ā…Ŗ Associate Member $ 50               ā…Ŗ I am interested in joining. Please have a member contact me.

    Institution: __________________________________________________________________________________________________________________

    Name: ______________________________________________________________________________     Title: ________________________________

    Address: ____________________________________________________________________________    City: _________________________________

    State/Province: _______________________      Zip/Postal Code: _______________________    Country:_____________________________

    Phone: _____________________________________ Fax: ____________________________________   E-mail: ______________________________

                                                                     Please remit to:
    ALL FEES ARE PAYABLE IN U.S. DOLLARS
                                                                     International Association of Museum Facility Administrators
                                                                     P.O. Box 277
    ā…Ŗ I enclose a check in the amount of $ ____________________
                                                                     Groton, MA 01450, USA
    ā…Ŗ Please invoice me
                                                                     Website: www.iamfa.org

34     PAPYRUS SUMMER–FALL 2010
Benchmarking: A Comparison over Time

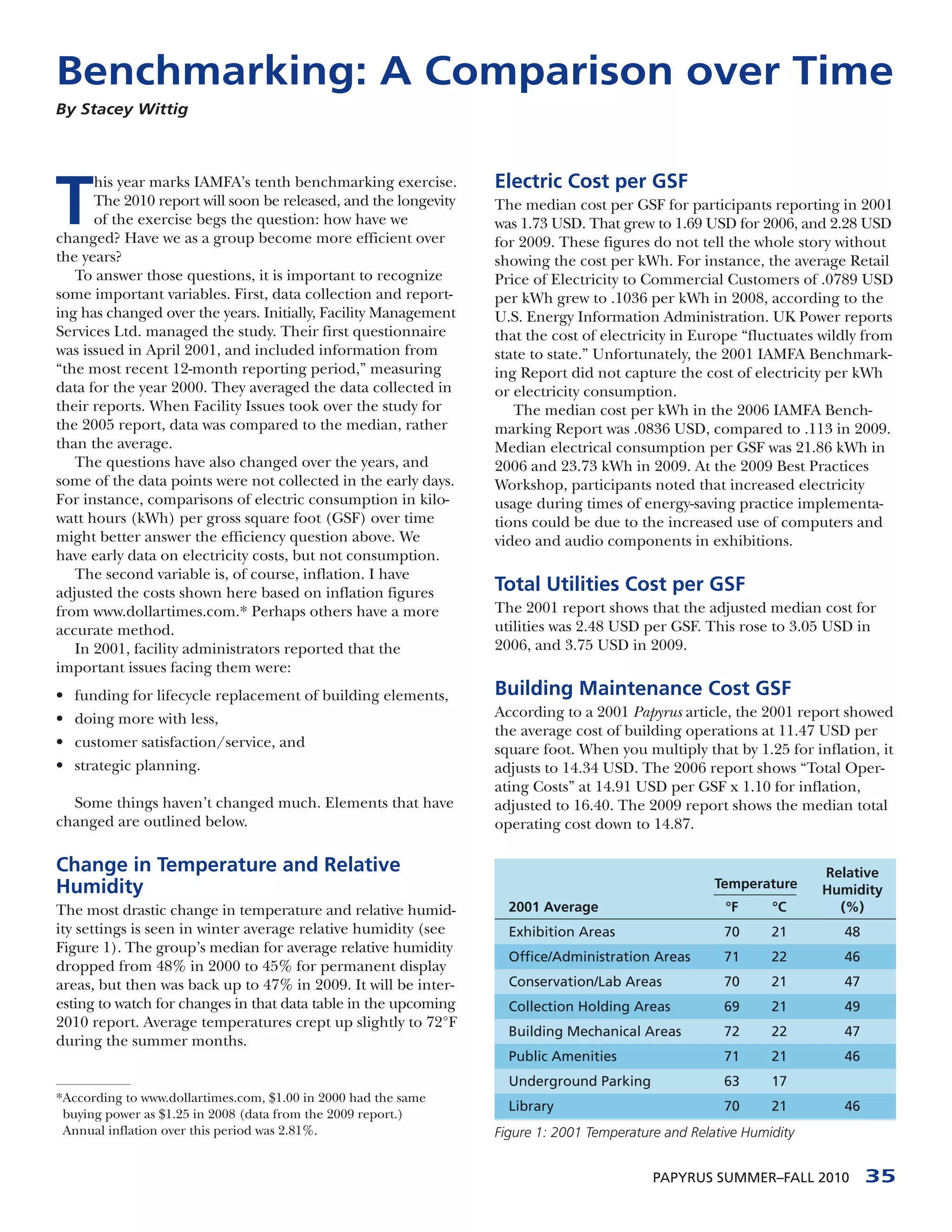

By Stacey Wittig

T
      his year marks IAMFA’s tenth benchmarking exercise.        Electric Cost per GSF
      The 2010 report will soon be released, and the longevity   The median cost per GSF for participants reporting in 2001
      of the exercise begs the question: how have we             was 1.73 USD. That grew to 1.69 USD for 2006, and 2.28 USD
changed? Have we as a group become more efficient over           for 2009. These figures do not tell the whole story without
the years?                                                       showing the cost per kWh. For instance, the average Retail
   To answer those questions, it is important to recognize       Price of Electricity to Commercial Customers of .0789 USD
some important variables. First, data collection and report-     per kWh grew to .1036 per kWh in 2008, according to the
ing has changed over the years. Initially, Facility Management   U.S. Energy Information Administration. UK Power reports
Services Ltd. managed the study. Their first questionnaire       that the cost of electricity in Europe ā€œfluctuates wildly from
was issued in April 2001, and included information from          state to state.ā€ Unfortunately, the 2001 IAMFA Benchmark-
ā€œthe most recent 12-month reporting period,ā€ measuring           ing Report did not capture the cost of electricity per kWh
data for the year 2000. They averaged the data collected in      or electricity consumption.
their reports. When Facility Issues took over the study for         The median cost per kWh in the 2006 IAMFA Bench-
the 2005 report, data was compared to the median, rather         marking Report was .0836 USD, compared to .113 in 2009.
than the average.                                                Median electrical consumption per GSF was 21.86 kWh in
   The questions have also changed over the years, and           2006 and 23.73 kWh in 2009. At the 2009 Best Practices
some of the data points were not collected in the early days.    Workshop, participants noted that increased electricity
For instance, comparisons of electric consumption in kilo-       usage during times of energy-saving practice implementa-
watt hours (kWh) per gross square foot (GSF) over time           tions could be due to the increased use of computers and
might better answer the efficiency question above. We            video and audio components in exhibitions.
have early data on electricity costs, but not consumption.
   The second variable is, of course, inflation. I have
adjusted the costs shown here based on inflation figures         Total Utilities Cost per GSF
from www.dollartimes.com.* Perhaps others have a more            The 2001 report shows that the adjusted median cost for
accurate method.                                                 utilities was 2.48 USD per GSF. This rose to 3.05 USD in
   In 2001, facility administrators reported that the            2006, and 3.75 USD in 2009.
important issues facing them were:
•   funding for lifecycle replacement of building elements,      Building Maintenance Cost GSF
•   doing more with less,                                        According to a 2001 Papyrus article, the 2001 report showed
                                                                 the average cost of building operations at 11.47 USD per
•   customer satisfaction/service, and                           square foot. When you multiply that by 1.25 for inflation, it
•   strategic planning.                                          adjusts to 14.34 USD. The 2006 report shows ā€œTotal Oper-
                                                                 ating Costsā€ at 14.91 USD per GSF x 1.10 for inflation,
  Some things haven’t changed much. Elements that have           adjusted to 16.40. The 2009 report shows the median total
changed are outlined below.                                      operating cost down to 14.87.

Change in Temperature and Relative                                                                                  Relative
Humidity                                                                                            Temperature     Humidity
The most drastic change in temperature and relative humid-         2001 Average                      °F      °C       (%)
ity settings is seen in winter average relative humidity (see      Exhibition Areas                  70      21        48
Figure 1). The group’s median for average relative humidity
                                                                   Office/Administration Areas       71      22        46
dropped from 48% in 2000 to 45% for permanent display
areas, but then was back up to 47% in 2009. It will be inter-      Conservation/Lab Areas            70      21        47
esting to watch for changes in that data table in the upcoming     Collection Holding Areas          69      21        49
2010 report. Average temperatures crept up slightly to 72°F
                                                                   Building Mechanical Areas         72      22        47
during the summer months.
                                                                   Public Amenities                  71      21        46
                                                                   Underground Parking               63      17
*According to www.dollartimes.com, $1.00 in 2000 had the same
                                                                   Library                           70      21        46
 buying power as $1.25 in 2008 (data from the 2009 report.)
 Annual inflation over this period was 2.81%.                    Figure 1: 2001 Temperature and Relative Humidity

                                                                                          PAPYRUS SUMMER–FALL 2010          35
Median Cost of Custodial Services (adjusted for inflation)     was up to 96%. Of those who had a plan, 81% reported
2001: 1.93 USD per SF                                          using the plan due to bomb threat or severe weather. It is
2006: 2.68 USD per SF                                          interesting that only 78% of those institutions with a disaster
2009: 2.85 USD per SF                                          recovery plan had practiced it within the previous 12 months.

Area Cleaned per FTE Worker                                    CMMS
2001: 26,600 square feet
                                                               In 2002, Computerized Maintenance Management Systems
2006: 18,960 square feet
                                                               (CMMS) were used by 53% of participants. By 2009, almost
2009: 18,683 square feet
                                                               90% of participants used CMMS for repair work requests.

ā€œDisaster Managementā€ changed to                               Stacey Wittig is the Marketing Director for Facility Issues. Places are
                                                               still available for observers at the 2010 ā€œBenchmarking Practices
ā€œDisaster Recoveryā€ to ā€œEmergency                              and Learning Workshop.ā€ www.facilityissues.com
Preparedness Planā€
In 2002, participants were asked if they had an up-to-date
disaster management plan. 83% said yes. In 2009, that figure

            Reserve this space to
                                                                                            Please contact the
            advertise in a future                                                           Editor of Papyrus
                                                                                                for details
              issue of Papyrus

                                                                Past issues of Papyrus
                                                          can be found on IAMFA's website
                                                                 www.IAMFA.org

36     PAPYRUS SUMMER–FALL 2010
Reflections on Papyrus
                                              By Pierre Lepage

Pierre Lepage

P
       apyrus: not a word you’d have in          produced mostly once a year—primarily        structured form of written communi-
       the back of your mind—or have             to promote the annual conference. It         cation with members. Accordingly, at
       an opportunity to use in daily            consisted of a two-pager mailed out          the 2001 Washington, D.C. conference,
conversation—unless you happened                 to IAMFA members. There was no               then-President of the Association, Peter
to be the editor of IAMFA’s newsletter.          real commitment in these early years         Fotheringham, directed the Board to
    Papyrus is actually a type of paper,         to produce a journal; the energies of        revamp the Papyrus newsletter in order
first manufactured in Egypt 5,000 years          the Board were directed to keep the          to provide IAMFA with a true journal
ago. Processed fibers from the stem              Association alive, and to ensure the         highlighting the achievements of the
of the three-meter-tall papyrus plant,           holding of an annual conference. At          Association and its members. The inten-
which grew along the banks of the Nile,          times, the newsletter might include an       tion was to give members a means of
provided a writing surface that was              article written about facilities issues or   sharing their initiatives for the benefit
easier to produce and handle than the            achievements, but this was largely left      of others, while also promoting best
parchment made of animal hide. The               to the goodwill of members.                  practices and keeping members in
plant was also used in the making of                 The first annual conference held         touch with activities at the regional
boats, mats, ropes, sandals and baskets.         in Europe—the highly successful 1998         level. The goal in implementing a well-
    The heritage of this medium as               conference in Edinburgh, a venue out-        structured and professional journal
a communication tool—along with                  side North America, with members             was not only to promote IAMFA, but
IAMFA’s mandate of promoting knowl-              from five countries in attendance—           was also a means of encouraging new
edge and communication among mu-                 awakened members to IAMFA’s poten-           members to join the Association. To
seum facilities professionals—made               tial. For perhaps the first time, members    achieve those goals, Papyrus had to
Papyrus the ideal name for IAMFA’s               realized that they truly belonged to an      include articles dealing with the nuts
newsletter.                                      international organization. From then        and bolts of facilities management, the
    The Papyrus newsletter evolved in            on, there was a major change in how          articles had to be credible and pro-
a way that parallels IAMFA’s growth.             IAMFA conducted its business and             fessional, and the journal had to be
It takes time to build an organization           membership activities. The annual con-       published with consistency at regular
from an informal group of a few like-            ference began to include an annual           intervals throughout the year. As
minded people, into an internationally           benchmarking exercise, making the            IAMFA’s newly elected Secretary,
recognized organization. And let us              membership more active and partici-          and Editor of Papyrus, I was the one
not forget that this non-profit and              patory. The position of Vice-President,      mandated to make it happen.
unsubsidized organization is managed             Regional Affairs was created, with the          I remember taking the opportunity
by a Board of Directors composed of              election of Carole Beauvais, who suc-        of having IAMFA members captive at
facilities management professionals.             cessfully promoted IAMFA, and was            the conference to obtain commit-
These elected Board members volun-               instrumental in initiating a number of       ments for articles for the new version
tarily dedicate time over and above their        new regional chapters. This expansion        of Papyrus. Upon returning from the
regular duties at their respective insti-        brought a tremendous need to open            conference, the structure of the journal
tutions, in order to maintain IAMFA’s            up communication with members in             was sketched out, Sheila and Neena
viability. It is worthwhile remembering,         order to share achievements and acti-        Singhal of Artistic License/Phredd
as well, that these individuals are gen-         vities initiated by members within their     Graphix were approached to discuss
erally from different countries, conti-          respective chapters. Around the same         design and layout options, determine
nents, and even different linguistic             time, Richard Kowalczyk created and          feasibility costs, and come up with a
backgrounds. All that being said, the            posted the IAMFA website: a highly           realistic production schedule for three
stature of the Association and Papyrus           successful medium that allowed mem-          issues in 2002.
today, after only 20 years, is a remarkable      bers to remain connected with their             The first edition of the new Papyrus
achievement.                                     Association on an ongoing basis.             came out in February 2002, designated
    Let me recount a little bit of history           This expansion and evolution of the      as the Winter 2002 issue, volume 3,
in the evolution of Papyrus. During its          Association’s business and activities at     number 1. The result was a 20-page
first ten years or so, the newsletter was        the end of the 1990s warranted a more        issue printed in two colors, promoting

                                                                                                PAPYRUS SUMMER–FALL 2010          37
the 2002 12th annual IAMFA confer-           ties on a daily basis, and to promote         • First issue introducing the
ence in London, and including eight          better management practices in cultural         production of an article in three
articles—two of which were submitted         facilities at an international level.           languages: English, French,
from sources outside the Association.            I have been retired now for five years,     Spanish
    The Board of Directors took the          and it is interesting to observe from a         Winter 2008
opportunity represented by the re-           distance the quantum leap that IAMFA
                                                                                           • First glossy full-colour issue
vamped Papyrus to promote IAMFA              and Papyrus have made over the past
                                                                                             Spring 2009
more heavily, and to seek the recruit-       10 years. It is more evident all the time
ment of new members. For that pur-           that this organization has a solid raison     • First issue with more than 40 pages
pose, the first print run was 1,000 copies   d’être. I also believe that the effort          Summer 2009
with 874 mailed to individual cultural       invested in promoting effective com-
                                                                                           • First issue with paid advertising
institutions in 46 countries.                munication with the membership—
                                                                                             Winter 2009
    Since that first issue of the revived    primarily through Papyrus—has gal-
newsletter, Papyrus has evolved and is       vanized the fundamental base of the           • First issue with a puzzle page
still published three times a year. It has   IAMFA organization, and that it con-            Spring 2010
become a reflection of the Association       tinues to promote the professionalism of
that it serves, which is why Papyrus         its members on an international scale.          My best wishes to IAMFA and
continues to evolve. It has become a             In conclusion, let me highlight some      Papyrus on their 20th Anniversary!
truely professional communications           fun facts about Papyrus:
tool, meant to broadcast IAMFA’s man-                                                      Pierre Lepage is a former Secretary of
                                             • First revamped issue of Papyrus             IAMFA and Editor of Papyrus, and is the
date, to recognize its membership’s
                                               Winter 2002                                 retired Director of Property Management,
achievements, to bring perspective                                                         Security, and Client Services for the
to the challenges that facilities profes-    • First issue with colour                     Canadian Museum of Civilization and
sional must deal with in cultural facili-      Summer 2007                                 the Canadian War Museum in Ottawa-
                                                                                           Gatineau, Canada.

38     PAPYRUS SUMMER–FALL 2010
Auckland Art Gallery Toi o TĀÆ
                            amaki
Building Development Update
By Patricia Morgan

T
       hose of you who were at the 2005      it has unfolded over the past 22 months.
       IAMFA conference in Bilbao            The following pictures provide a snap-
       may recall that I gave a presenta-    shot of what we have achieved since
tion on the major building development       construction began.
Auckland Art Gallery Toi o TĀÆ maki
                                a                Achieving what you can see in the
was about to undertake. The focus was        images has involved over 500,000 hours
on the constraints and challenges of         work onsite to date, with around 160
the site: its heritage/historical context    personnel now working on the site on
and location, as well as limited oppor-      any given day. This does not take into
tunities to increase the building’s foot-    account the people involved in offsite
print. It was in response to that pre-       fabrication of the beautiful kauri soffits
sentation that I was invited to host a       or other aspects of the building. Over
future IAMFA conference, which we            20,000 m3 of excavated material has
are now well into planning—so mark           been removed from the site to create
your diaries for November 13–17,             plant rooms—and above that, a full
2011 in Auckland New Zealand!                lower ground level of mainly back-of-
    Back at the Guggenheim in Spain—         house space. 5,000 m3 of concrete has
or was it the Maritime Museum?—I             been used on the site, as has 400 tonnes
optimistically titled my presentation        of structural steel. In creating the beau-
ā€œAuckland Art Gallery 2009ā€, which           tiful kauri ceilings and columns, 200 m3
was when we expected to re-open.             of fallen New Zealand kauri timber has
Well . . . it would be another three         been used—a story in itself that I will
years before work commenced on the           save for another time!—and the glass
site, as we suffered a number of delays      walls of the north atrium, an innovative     Auckland Art Gallery Toi o Tamaka.
                                                                                                                      ĀÆ
working through the consents process.        tensioned faƧade system, will be the
It was not until September 2008 that the     largest in southern hemisphere. Hawkins      me that there are 15 different faƧade
construction team, Hawkins Construc-         project manager Grant Thomas tells           types in the building design!
tion, was finally onsite and commenced
work. With construction estimated to
take around 30 months, and with a fur-
ther three months for our opening exhi-
bition installations and relocation inside
the building, we are now expecting to
re-open to the public in mid-2011.
    We were always determined that
Aucklanders would be able to see the
progress onsite as it occurred, as our
ratepayers are funding 46% ($56M) of
this $121M project. So one of the first
things we did, as part of our commu-
nications strategy, was to set up a web-
cam from a building across the road.
This gave people a very good overview
of the northern end of the building,                                                                   Key:
where the major construction activity                                                                  Red dotted line = boundary
would occur (www.aagwebcam.com).                                                                       Dark grey = heritage buildings
This webcam, which renews every                                                                        White & pale grey = new build

15 minutes, has given us an amazing
record of the building construction as       The site of the Art Gallery building.

                                                                                            PAPYRUS SUMMER–FALL 2010              39
September 2008: Demolition of the 1970s       November 2008: Demolition continues.         November 2008: The remaining heritage
building begins.                                                                           buildings.

May 2009: The new building starts to go up!                         September 2009: Twelve months into construction.

March 2010: Roofs under construction—the race is on to make it      July 2010: The roofs are going on!
watertight!

40     PAPYRUS SUMMER–FALL 2010
Materials for the building have come      south atriums; American white oak for           will be a world-class art museum—the
                  from a variety of sources, in order to       the floors of the gallery spaces; and spe-      largest building in New Zealand dedi-
                  achieve the quality finish that has always   cialized glass which was sourced from           cated to the display of visual arts—and
                  been fundamental to the project. These       Europe, America and Asia, to provide            we know life can only get better.
                  include kauri wood from New Zealand          the building with transparency and light,          The benefits of the redeveloped art
                  for the spectacular ceilings in the north    and to enhance the connection between           gallery can be seen at a glance in the
                  atrium, the external canopies and the        the adjacent park and cityscape.                graph below.
                  barrel vault ceilings of the daylit con-        A fundamental component of the                  Although a key driver for this
                  temporary gallery on Level 2; jura stone     design that architects FJMT+Archimedia          $121-million project was to seismi-
                  from Germany for the exterior walls of       presented to us at the concept stage was        cally strengthen the 1887 building and
                  the new build; Portuguese moleanos           the building’s relationship with the park.      to bring it up to building code stan-
                  stone for interior walls in the north and    Their early concept design captured             dards, when we complete the project
                                                               what has become a major aspect—the              we will have much more than a stronger
                                                               fourth dimension—of the building.               building capable of withstanding seismic
FJMT+ARCHIMEDIA

                                                               The canopy of trees in Albert Park,             activity. Not only will Auckland have a
                                                               particularly the Pohutakawa trees,              public art gallery that values its archi-
                                                               formed the basis for the design of the          tectural heritage and its unique site,
                                                               soaring roof canopies of the north              but we will also have an iconic con-
                                                               atrium, which protrude beyond the               temporary building appropriate to
                                                               building to the east and west, forming          house the country’s finest art collec-
                  Roof concept design—FJMT+Archimedia.         canopies over external areas adjacent           tion—a collection of around 14,500
                                                               to the building.                                works. The juxtaposition of restored
                                                                  It is only in the last few weeks that        and reinstated heritage and modern
FJMT+ARCHIMEDIA

                                                               the kauri soffits, which are being fabri-       public exhibition spaces will combine
                                                               cated offsite, have started to be installed     to offer an enjoyable visitor experience
                                                               —inch by painstaking inch. Although             that enriches the understanding and
                                                               only a few are yet visible in situ, due to      meaning of art.
                                                               the forest of scaffolding in the north             We cannot wait to share with you
                                                               atrium, it is already clear what a feature      some of the stories of our building
                                                               of the finished building they will be.          redevelopment—be it the re-creation
                                                               Recent site visits have given us an oppor-      of the 1916 daylit gallery, the Maori
                                                               tunity to get up close and personal to          dimension of the building, the kauri
                  Concept sketch for the building’s kauri      the kauri soffits.                              story, or myriad other tales that have
                  roof canopy.                                    With 12 months to go before we open          evolved with the building itself.
                                                               to the public, there is no likelihood              So do join us in November 2011
                                                               that life is going to get any quieter for       in Auckland to see and experience
                                                               us—but there is no doubt that excite-           Auckland Art Gallery, Toi o TĀÆ maki
                                                                                                                                               a
                                                               ment is mounting for Gallery staff!             for yourselves!
                                                               Our recent staff tour of the site drew
                                                               an overwhelmingly positive response.            Patricia Morgan is Manager, Business
                                                               Just to be back together in one place,          Support at the Auckland Art Gallery—
                                                                                                               Toi O Tamaki in Auckland New Zealand.
                                                                                                                       ĀÆ
                                                               instead of spread over four different           Pat will host the 21st IAMFA Annual
                                                               sites, will in itself be a relief. Fold in to   Conference scheduled for November
                                                               that the opportunity to work in what            13–17, 2011.

                  Scaffolding in the north atrium.

                  Installation of kauri soffit in the north    The benefits of the redeveloped art gallery.
                  atrium.

                                                                                                                 PAPYRUS SUMMER–FALL 2010          41
Regional Updates/Member News
New York Chapter Update                                           year. This success has put

                                                                                                                                    Ā© HAYES DAVIDSON AND
                                                                                                                                     HERZOG & DE MEURON
                                                                  pressure on our existing
                                                                  facilities and program.
                                                                     Different kinds of
                                                                  gallery spaces are need-
                                                                  ed to better display the
                                                                  works in the Collection.
                                                                  Film, video, photog-
                                                                  raphy and perfor-
                                                                  mance have become
                                                                  more essential strands
                                                                  of artistic practice, and
                                                                  artists have embraced       View of the Tate Modern from the
                                                                  new technologies.           south at dusk.
                                                                  Ambitious and imagi-
                                                                  native installations are now pushing traditional gallery
Meeting of the New York Chapter at the Cooper-Hewitt National     spaces to their limits.
Design Museum.
                                                                  Switch Station and Oil Tanks: An Ideal Opportunity
                                                                  to Expand
A chapter organizational meeting was held in New York City        The opening of the Tate Modern in May 2000 was intended
on June 16 at the Cooper-Hewitt National Design Museum.           as the first stage in the development of the former Bankside
The turnout was terrific, with representatives from several       Power Station. It was always envisaged that the derelict oil
organizations.                                                    tanks and the switch station to the south of the site could
   John Castle started off with a brief history of IAMFA, dis-    eventually be integrated into the gallery.
cussing chapter activities and annual conferences. Nancy             The electrical switch station is still used to power a large
Bechtol from the Smithsonian Institution then talked about        part of the City and South London. EDF, which owns the
her perspective on benchmarking. She was followed by Jeff         station, is modernising its equipment so it will take up a
Ridgeway, also of the Smithsonian, who discussed what bench-      smaller part of the building. This provides us with an ideal
marking means to him operationally. Finally, John got up          opportunity to expand the Tate Modern, with the oil tanks
again and showed what he presents to his Buildings Com-           forming the foundation of the new building.
mittee and Trustees regarding benchmarking, and what
they need to know regarding facilities management at the          A Transformed Tate Modern
Winterthur Museum. It was clear to all what an important          The expansion will create a less congested, more welcom-
benefit benchmarking is to IAMFA members.                         ing environment. The exhibition and display space will be
   After a superb lunch of sandwiches and chips, there was        almost doubled, enabling us to show more of our Collection.
a question-and-answer session—more like an open-mike              There will be more cafes, terraces and concourses in which
moment—then a house tour of the Cooper-Hewitt.                    to meet and unwind.
   Jeff Ridgway and Mark DeMairo will work in concert on
the next chapter meeting. In fact, two people volunteered                                                                           COURTESY LOBSTER PICTURES LTD 2010, Ā© TATE

their respective facilities to host a meeting. So it looks very
encouraging that the New York City Chapter will become a
very active player within IAMFA.

U.K. Chapter Update
By David Redrup

The next U.K. Annual IAMFA meeting will be hosted by the
Tate Modern on April 13, 2011. This meeting will focus on
the exciting new project that will transform the Tate Modern.

The Reasons for Transforming the Tate Modern
The Tate Modern was designed for two million annual               Live image feed of new building project at the Tate Modern,
visitors. It now receives around five million visitors each       July 15, 2010.

42     PAPYRUS SUMMER–FALL 2010
Learning will be at the heart of the new Tate Modern,         progress and changes that have occurred at our venues. It
                                          reflecting the Tate’s commitment to increasing public knowl-     also gets us out of the office on a regular basis! Amazingly,
                                          edge and understanding of art. There will be a range of          we already have a draft programme for delegates, although
                                          new facilities throughout the building for deeper engage-        the guest programme is proving more challenging, as there
                                          ment with art: interpretation, discussion, private study,        is simply too much choice! Nevertheless, we will focus on
                                          participation, workshops and practice-based learning.            what can be humanly achieved and experienced within
                                                                                                           three–four days, but with the absolute prerogative to give
                                          Closer to the Community                                          you a taste of what Aotearoa (New Zealand) is all about!
                                          The Tate Modern is part of the neighbourhood. Its presence           Last month we met at MOTAT: the Museum of Transport
                                          has made a major contribution to the ongoing revitalisation      and Technology. I am embarrassed to confess that it is many
                                          of Southwark, and it recognises the importance of building
                                          strong links with the local community. The Transforming Tate

                                                                                                                                                                           NICK SERVIAN
                                          Modern project will be a catalyst for engaging local audiences
                                          more deeply, and broadening access to the museum.
                                             The new development will continue to bolster the growth
                                          of the borough. A public walkway through the building will
                                          make possible a direct route from the City to the heart
                                          of Southwark. There will also be two new public squares
                                          to the south and west of the building. And finally, To the
                                          east, a new planted area will be created especially for the
                                          use of the local community and staff.
Ā© HAYES DAVIDSON AND HERZOG & DE MEURON

                                                                                                           Kapa Haka group.

                                                                                                                                                                           PETER MORETH
                                          View of the Tate Modern from the southeast.

                                          New Zealand Chapter Update
                                                                                                           The Southern Alps.
                                          By Patricia Morgan

                                          Kia ora IAMFA members!
                                                                                                                                                                           NICK SERVIAN

                                             IAMFA 2011, here we (and hopefully all of you) come!
                                             The Auckland-based organising committee for the
                                          November 2011 conference—IAMFA’s ā€œcoming of ageā€
                                          conference, its 21st—has been meeting and planning since
                                          the end of 2009. The organising committee is comprised
                                          of: Patricia Morgan (Auckland Art Gallery), Paul Ivory
                                          (Auckland City Council), Natalie Hansby (Auckland Zoo),
                                          Paul Evans (Voyager, NZ Maritime Museum), Bridgette
                                          Robinson (Museum of Transport and Technology) and
                                          Adam Taylor (Auckland Museum).
                                             We meet monthly at each venue in rotation, which gives
                                          us all an opportunity to refamiliarise ourselves with all the    Alfresco dining in Wellington.

                                                                                                                                     PAPYRUS SUMMER–FALL 2010      43
years since I visited MOTAT—not since my adult sons were
               young, and fascinated by all things mechanical (how simple
               life was then!). What a difference and what a great venue
               for you all to visit and to be charmed by! The fact that it is
               right next door to the Auckland Zoo means you will enjoy
               a wonderful day at Western Springs, visiting both of these
               absorbing venues!
                   Meetings at the Auckland Art Gallery are far less inter-
               esting at the moment, as the majority of Gallery staff are
               housed in a Council highrise. Thankfully, however, we are
               within five minutes of the Gallery building site—and before
               too long the organising committee will be able to have a
               guided tour of what is very quickly becoming a recognisable
               art gallery. (Check out the story on progress elsewhere
               in Papyrus.)
                                                                                                 Front entrance of the Baltimore Museum of Art.
                   We are currently considering what we can present you
               with at the San Francisco conference, in order to whet your
               appetites and make a trip to Auckland next November 2011                          annual conference in San Francisco, where they will get a
               a ā€œmust-doā€ in all your diaries. I am not sure we can reach                       chance to meet up with old friends and participate in the
               Joe’s poetic heights—the bar has been set rather high—but                         all the festivities the planning committee has planned! The
               we will do our best! In the meantime: a few images of our                         next Washington, D.C.-Baltimore Chapter meeting will
               beautiful country to capture your imagination, so that you                        take place in January 2012.
               will start preparing your travel business case!
                   Haere rĀÆ .
                           a                                                                     New England Regional Chapter Meeting
                                                                                                 On June 14, members of the New England Regional
GARETH EYRES

                                                                                  KIERAN SCOTT

                                                                                                 Chapter met to tour the new 230,000-square-foot addition
                                                                                                 at the Museum of Fine Arts in Boston. The Museum is
                                                                                                 installing artwork in over 50 new galleries, and will display
                                                                                                 its ā€œArt of the Americasā€ collection in exquisite new case-
                                                                                                 work manufactured by Laboratorio Museotecnico Goppion,
                                                                                                 of Milan, Italy. A behind-the-scenes tour included the new
                                                                                                 39,000-square-foot plant area which houses three new high
                                                                                                 temperature hot-water boilers, three 600-ton centrifugal
                                                                                                 chillers with plate and frame heat exchanger, and new 13.8 KV
                                                                                                 8,000 amp electric service. Air-handling units are equipped
                                                                                                 with new ā€œfan wallā€ technology and gas filtration. Humidifi-
                                                                                                 cation is generated by four Cemline unfired steam boilers.
                                                                                                 The new glass-enclosed courtyard is heated and cooled by
                                                                                                 a combination of radiant floor and high-velocity air curtain
               The Bay of Islands.              Auckland Central Business                        along glass. Group discussions included issues with new
                                                District.
                                                                                                 display vignettes, lighting, and energy consumption. The
                                                                                                 New Wing is scheduled to open in mid-November 2010.
               Washington, D.C.-Baltimore Chapter
               By Maurice Evans

               The Washington, D.C.-Baltimore Chapter will be holding its
               last chapter meeting for the year on August 26 at 11:00 a.m.
               The meeting will be hosted by Alan Dirican of the Baltimore
               Museum of Art. Vicky Kiechel who is an Architect AIA,
               LEED AP, a Professor at the University of Maryland, and
               a member of the environmental firm The Cadmus Group,
               will be the guest speaker for this meeting. Vicky will be giving
               a dynamic presentation on LEED Certification for a Facility
               Manager. The Chapter is looking forward to another great
               meeting, and will be returning to the Baltimore Museum
               of Art, where we held the annual benchmarking during
               last year’s conference. Members of the Washington, D.C.-                          Members of the New England Regional Chapter at the Museum
               Baltimore Chapter are looking forward to attending the                            of Fine Arts in Boston.

               44      PAPYRUS SUMMER–FALL 2010

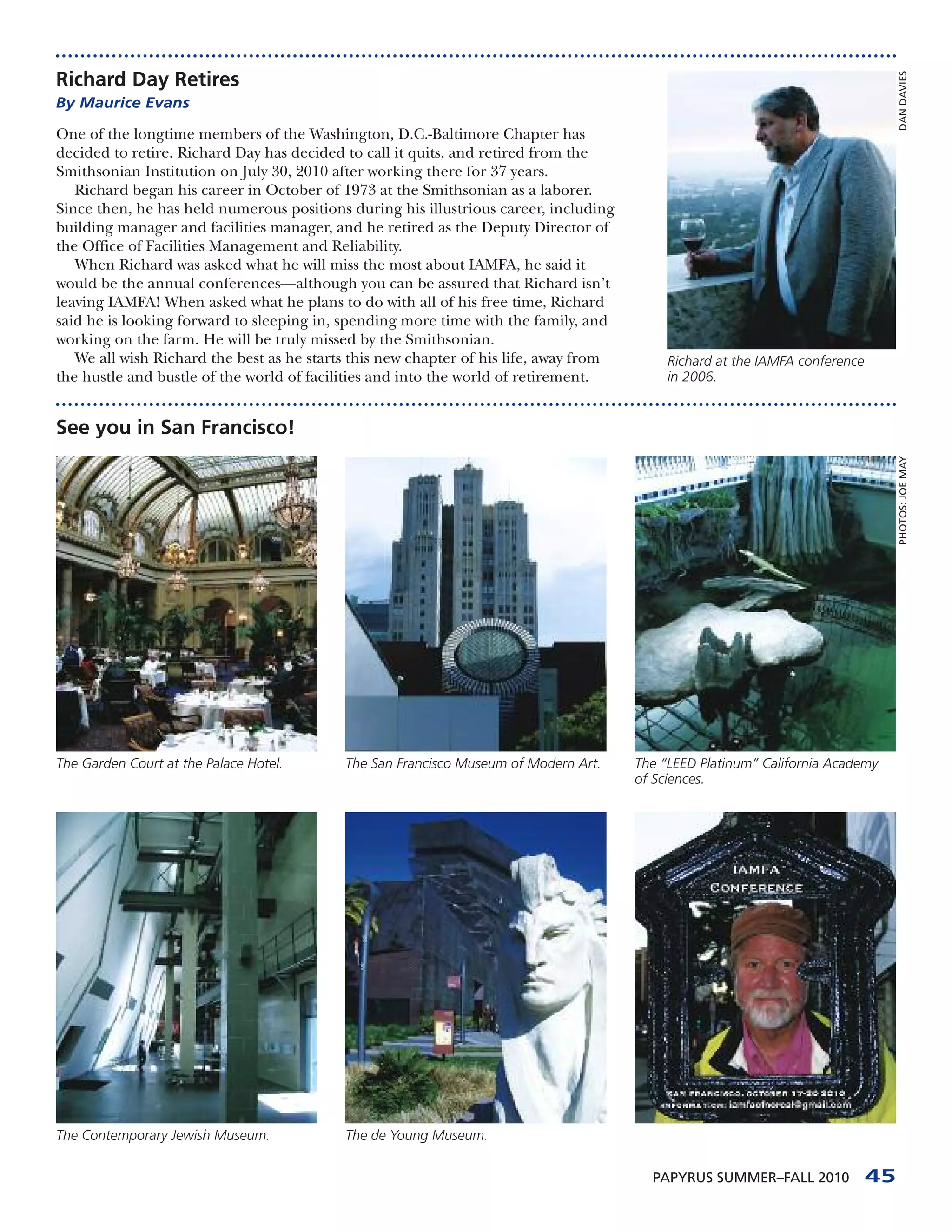

Richard Day Retires

                                                                                                                                   DAN DAVIES
By Maurice Evans

One of the longtime members of the Washington, D.C.-Baltimore Chapter has
decided to retire. Richard Day has decided to call it quits, and retired from the
Smithsonian Institution on July 30, 2010 after working there for 37 years.
   Richard began his career in October of 1973 at the Smithsonian as a laborer.
Since then, he has held numerous positions during his illustrious career, including
building manager and facilities manager, and he retired as the Deputy Director of
the Office of Facilities Management and Reliability.
   When Richard was asked what he will miss the most about IAMFA, he said it
would be the annual conferences—although you can be assured that Richard isn’t
leaving IAMFA! When asked what he plans to do with all of his free time, Richard
said he is looking forward to sleeping in, spending more time with the family, and
working on the farm. He will be truly missed by the Smithsonian.
   We all wish Richard the best as he starts this new chapter of his life, away from        Richard at the IAMFA conference
the hustle and bustle of the world of facilities and into the world of retirement.          in 2006.

See you in San Francisco!

                                                                                                                                   PHOTOS: JOE MAY
The Garden Court at the Palace Hotel.      The San Francisco Museum of Modern Art.     The ā€œLEED Platinumā€ California Academy
                                                                                       of Sciences.

The Contemporary Jewish Museum.            The de Young Museum.

                                                                                         PAPYRUS SUMMER–FALL 2010             45
IAMFA Members — Organizations
                                National Gallery of Canada   English Heritage                 Baltimore Museum of Art
       AUSTRALIA                Ottawa, Ontario              London, England                  Baltimore, MD

Australian Centre for the       Nova Scotia Museum           Imperial War Museum              Berkeley Art Museum/
Moving Image                    Halifax, Nova Scotia         London, England                  Pacific Film Archive
Melbourne, VIC                                                                                Berkeley, CA
                                Physical Resource Bureau     The National Archives
Australian National Maritime    Ottawa, Ontario              Richmond, Surrey                 Boston Athenaeum
Museum                                                                                        Boston, MA
                                Royal British Columbia       National Galleries of Scotland
Sydney, NSW                                                  Edinburgh, Scotland
                                Museum                                                        Brooklyn Museum of Art
Museum Victoria                 Victoria, British Columbia                                    Brooklyn, NY
                                                             National Gallery, London
Carlton, Victoria                                            London, England
                                Royal Ontario Museum                                          Camfill Farr
National Gallery of Australia   Toronto, Ontario                                              North Grafton, MA
                                                             National Library of Scotland
Canberra, ACT                                                Edinburgh, Scotland              Chicago Children’s Museum
National Gallery of Victoria               FRANCE            National Maritime Museum
                                                                                              Chicago, IL
Melbourne, Victoria                                          Greenwich, England               Cleveland Museum of Art
                                BibliothĆØque Nationale                                        Cleveland, OH
National Library of Australia   de France                    National Museum of Science
Canberra, ACT
                                Paris                        and Industry                     Columbus Museum of Art
National Portrait Gallery                                    London, England                  Columbus, OH
                                International Council
of Australia                    of Museums                   National Museums Liverpool       Cooper-Hewitt, National
Canberra, ACT                                                Liverpool, England
                                Paris                                                         Design Museum
Steensen Varming                                                                              New York, NY
                                                             National Portrait Gallery
Sydney, NSW
                                        NEW ZEALAND          London, England                  Corporate Care
                                                                                              Houston, TX
                                                             Natural History Museum
         CANADA                 Auckland Art Gallery —       London, England                  Cypress Security, LLC
                                Toi o TĀÆ
                                       amaki                                                  San Francisco, CA
Black & McDonald Limited        Auckland                     Tate
Ottawa, Ontario                                              London, England                  Delaware Art Museum
                                Christchurch Art Gallery                                      Wilmington, DE
Bureau de la transformation     Te Puna O Waiwhetu           University of Greenwich
                                Christchurch, Canterbury     London, England                  DFI Resources, LLC
de la DGSDE
Ottawa, Ontario                                                                               Austin, TX
                                                             The Wellcome Trust
                                           RUSSIA            London, England                  Energy Maintenance Services
Camfil Farr Canada Inc.
Ottawa, Ontario                                                                               Houston, TX
                                A. A. Bakhrushin State           UNITED STATES                Ewing Cole
Canada Science and
                                Central Theatre Museum                                        Philadelphia, PA
Technology Museum               Moscow
Corporation                                                  AFS Chemical Filtration          Exploratorium
Ottawa, Ontario                                              Group                            San Francisco, CA
                                            SPAIN            Burlington, MA
Canadian Museum of                                                                            Facility Issues
Civilization                                                 Allentown Art Museum             Munds Park, AZ
Gatineau, Quebec                Museo Guggenheim —           Allentown, PA
                                Bilbao                                                        Fine Arts Museum of
Canadian Museum of Nature       Bilbao, Viz Caya             Anacostia Community              San Francisco
Ottawa, Ontario                                              Museum                           San Francisco, CA
                                                             Washington, DC
Facility Management               UNITED KINGDOM                                              Freer Gallery of Art and
Services LTD                                                 Architrve PC Architects          Arthur M. Sackler Gallery
Calgary, Alberta                                             Washington, DC                   Washington, DC
                                British Library
Groupe Smi-Enerpro              London, England              Arkansas Art Center              Friends of Iolani Palace
Longueuil, Quebec                                            Little Rock, AR                  Honolulu, HI
                                British Museum
Library and Archives Canada     London, England              Art Institute of Chicago         Glide Foundation
Gatineau, Quebec                                             Chicago, IL                      San Francisco, CA
                                Camfil Limited
Lundholm Associates             Haslingden, Lancashire       Arts and Industries Building     Hagley Museum & Library
Architects                                                   Washington, DC                   Wilmington, DE
                                Creative Consulting
Toronto, Ontario
                                Partnership LLP
                                London, England

46      PAPYRUS SUMMER–FALL 2010
Harley-Davidson Museum           Museum of Contemporary        National Museum of the            Smithsonian Institution
Milwaukee, WI                    Art — Chicago                 United States Army                Washington, DC
                                 Chicago, IL                   Fort Belvoir, VA
Harvard Art Museum                                                                               Smithsonian Institution
Cambridge, MA                    Museum of Fine Arts —         National Portrait Gallery         Building, The Castle
                                 Boston                        Washington, DC                    Washington, DC
Henry Ford Museum                Boston, MA
Dearborn, MI                                                   National Postal Museum            Smithsonian National Air
                                 Museum of Fine Arts —         Washington, DC                    and Space Museum
Henry Morrison Flagler           Houston                                                         Suitland, MD
Museum                           Houston, TX                   National Zoological Park
Palm Beach, FL                                                 Washington, DC                    Solomon R. Guggenheim
                                 National Air and Space                                          Museum
High Museum of Art               Museum                        Neue Galerie                      New York, NY
Atlanta, GA                                                    New York, NY
                                 Washington, DC
                                                                                                 Stanford University Green
Hirshhorn Museum and             National Air and Space        Newark Museum                     Library
Sculpture Garden                                               Newark, NJ
                                 Museum —                                                        Stanford, CA
Washington, DC
                                 Udvar-Hazy Center             Norton Museum of Art
                                 Chantilly, VA                                                   U.S. Holocaust Museum
Isabella Stewart Gardner                                       West Palm Beach, FL
                                                                                                 Washington, DC
Museum                           National Gallery of Art —
Boston, MA                                                     Office of Facilities              The Whiting-Turner
                                 Washington                    Engineering & Operations
                                 Washington, DC                                                  Contracrting Company
J. Paul Getty Trust                                            Washington, DC
                                                                                                 Baltimore, MD
Los Angeles, CA
                                 National Museum of African    Peabody Essex Museum
                                 American History and                                            Winterthur Museum, Garden
The Jewish Museum                                              Salem, MA
                                 Culture                                                         and Library
New York, NY
                                                               Philadelphia Museum of Art        Winterthur, DE
                                 Washington, DC
Landmark Facilities Group,                                     Philadelphia, PA
                                 National Museum of African                                      Yale University Art Gallery
Inc.                                                                                             New Haven, CT
Norwalk, CT                      Art                           Questions and Solutions
                                 Washington, DC                Engineering, Inc.
Library of Congress                                            Chaska, MN
Washington, DC                   National Museum of                                                   This list reflects
                                 American History              Renwick Gallery
Lighting Services Inc.           Washington, DC                Washington, DC                          membership
Stony Point, NY                                                                                       dues paid as of
                                 National Museum of Marine     Rutherford & Chekene                    July 15, 2010
Los Angeles County Museum        Corps                         San Francisco, CA
of Art                                                                                             Although we do our best
                                 Triangle, VA                  San Francisco Maritime
Los Angeles, CA                                                                                         to ensure that our
                                 National Museum of Natural    National Historic Park               Directory information is
Mariner’s Museum                 History                       San Francisco, CA
                                                                                                   as up-to-date as possible,
Newport News, VA                 Washington, DC                San Francisco Museum of             errors and omissions can
McGuire Engineers                National Museum of the        Modern Art                             always occur. If you
Chicago, IL                      American Indian               San Francisco, CA                    would like to make any
                                 Washington, DC                                                          changes to your
Milwaukee Public Museum                                        Smithsonian American Art
Milwaukee, WI                                                  Museum                                listing, please contact
                                 National Museum of the                                                 Larry Bannister at
                                 American Indian —             Washington, DC
Morikami Museum and                                                                                  bannister@mpm.edu
Japanese Gardens                 George Gustav Heye Center
Delray Beach, FL                 New York, NY

                                 Become a Member of IAMFA
                                       For more information on becoming a member of the
                             International Association of Museum Facility Administrators, please visit
                                                             WWW.IAMFA.ORG

                                                                                           PAPYRUS SUMMER–FALL 2010        47
Puzzle Page

48   PAPYRUS SUMMER–FALL 2010
Papyrus Fall 2010
Papyrus Fall 2010

Papyrus Fall 2010

  • 1.
    I N TE R N AT I O N A L A S S O C I AT I O N O F M U S E U M F A C I L I T Y A D M I N I S T R AT O R S PAPYRUS VOL. 11, NO. 2 SUMMER–FALL 2010 Celebrating Years The 20th Annual IAMFA IAMFA Conference Reflections on The First Twenty Years in San Francisco, CA Papyrus
  • 2.
    Contents Letter from theEditor Facility Managers Lead the Move 1 to Green with Improvements in Energy Efficiency Message from the President / 30 Mot du prĆ©sident / Mensaje del Presidente Benchmarking: 2 A Comparison over Time 35 IAMFA . . . The First Twenty Years 6 Reflections on Papyrus 37 The Twentieth Annual IAMFA Conference in San Francisco / Auckland Art Gallery Toi o TĀÆ amaki: La VingtiĆØme ConfĆ©rence de l'IAMFA Building Development Update Ć  San Francisco / 39 La VigĆ©sima Conferencia Anual de IAMFA en San Francisco Regional Updates/Member News 15 42 2010 IAMFA Conference Schedule IAMFA Members—Organizations 24 46 The National Gallery: Puzzle Page Casting New Light on Old Masters 48 28 Cover photo: San Francisco's famous Golden Gate Bridge. Photo: Joe May IAMFA BOARD OF DIRECTORS REGIONAL CHAPTERS President Secretary and Papyrus Editor Atlanta, U.S.A. — Kevin Streiter, Ottawa-Gatineau, Canada — John de Lucy Joseph E. May High Museum of Art Ian MacLean, Canada Science and kevin.streiter@woodruffcenter.org Technology Museum Corporation The British Library Sustainability Engineer imaclean@technomuses.ca London, United Kingdom Los Angeles, CA, USA Australia — Ray McMaster, Australian john.delucy@bl.uk joemay001@hotmail.com National Maritime Museum Philadelphia, USA — John Castle, rmcmaster@anmm.gov.au Winterthur Museum & Garden jcastle@winterthur.org V.P., Administration Chairman — Conference 2010 Bilbao, Spain — Rogelio Diez, Alan Dirican Guggenheim Museum San Francisco, USA — Joe Brennan, Joe Brennan rdiez@guggenheim-bilbao.es San Francisco Museum of Modern Art Baltimore Museum of Art San Francisco Museum of jbrennan@sfmoma.org Baltimore, MD, USA Modern Art Chicago, USA — William Caddick, adirican@artbma.org Art Institute of Chicago United Kingdom — Jack Plumb, San Francisco, CA wcaddick@artic.edu National Library of Scotland jbrennan@sfmoma.org j.plumb@nls.uk V.P., Regional Affairs Los Angeles, USA — Randy Murphy, John Castle Los Angeles County Museum of Art Washington/Baltimore, USA — Head of International Affairs rmurphy@lacma.org Maurice Evans, Smithsonian Winterthur Museum, Guy Larocque Institution Garden and Library New England, USA — John H. Canadian Museum of evansma@si.edu Winterthur, DE, USA Lannon, Boston Athenaeum Civilization lannon@bostonathenaeum.org jcastle@winterthur.org For more information on Gatineau, QC, Canada New York, USA — Mark Demairo, becomming a member of the Treasurer guy.larocque@civilization.ca Neue Galerie International Association of Larry Bannister markdemairo@neuegalerie.org Museum Facility Administrators, Milwaukee Public Museum For additional contact information, New Zealand — Patricia Morgan, please visit Milwaukee, WI, USA please visit our website at Auckland Art Gallery www.iamfa.org bannister@mpm.edu www.iamfa.org patricia.morgan@aucklandcity.govt.nz IAMFA/ Papyrus Vincent Magorrian Editing Statements of fact and opinion Vol. 11, Number 2 Joe May Artistic License (English) are made on the responsibility of Summer–Fall 2010 Patricia Morgan Guy Laroque (French) authors alone and do not imply an Marla Neustadt opinion on the part of the editors, Printed in the U.S.A. by officers, or members of IAMFA. The Editor David Redrup Knight Printing editors of IAMFA Papyrus reserve the Joe May Steve Vandyke right to accept or to reject any Article Thomas A. Westerkamp or advertisement submitted for Papyrus Correspondents ISSN 1682-5241 publication. John Castle Design and Layout Daniel Davies Phredd Grafix While we have made every attempt to Peter Fotheringham ensure that reproduction rights have Guy Larocque Translation been acquired for the illustrations John de Lucy Marina Pascal (French) used in this newsletter, please let us know if we have inadvertently Maurice Evans Jeanne Pascal (Spanish) overlooked your copyright, and Pierre Lepage we will rectify the matter in a future issue. Past issues of Papyrus can be found on IAMFA's website: www.IAMFA.org
  • 3.
    Letter from theEditor Joe May Editor, Papyrus Greetings from Los Angeles! Pierre was responsible for turning the I haven’t missed an IAMFA confer- original two-page Papyrus newsletter into ence since attending my first one in I AMFA is celebrating a significant the journal that it is today. He was also San Francisco in 2003. By the end of birthday this year: Twenty Years! one of the early members of IAMFA, and that conference, I knew that I wanted The Association’s origins date back his article provides some interesting to become an active member of the to a first meeting at the Art Institute background on the Association. organization. If you’ve attended an of Chicago in 1990, organized by the As always, we also have some great IAMFA conference before, you already Institute’s Director of Facilities, George articles on the nuts and bolts of what know the benefits of belonging to an Preston. To begin our twentieth anni- organization made up of colleagues versary celebration, I hope you will read with responsibilities similar to yours. the retrospective article in this issue of If you haven’t attended before, now Papyrus, which looks back over our first IAMFA is thriving, and it is the time to get involved. Details of twenty years. And please . . . if you have this fall’s 20th Anniversary conference will continue to be the special memories of your involvement in San Francisco can be found in this with IAMFA, I encourage you to send leading organization for issue. If you haven’t made your plans them to me so we can add them to the yet, please make them soon. The block Association’s official record. IAMFA is facilities professionals at of rooms at the Sir Francis Drake Hotel thriving, and it will continue to be the is limited, and there is an early regis- leading organization for facilities pro- cultural institutions for tration discount if you register soon. fessionals at cultural institutions for Don’t wait to secure your reservations decades to come. Our twentieth anni- decades to come. —and be sure to show the guest agenda versary is a good opportunity to gather to your family. San Francisco is an the best possible historical record of amazing city for our fall conference, those early years for future members we do, including Steve Vandyke’s article and you won’t find a better value for of the organization. on blind controls at the National Gallery this level of learning and networking. In addition to the retrospective a in London, Tom Westerkamp’s article Lastly, thank you to everyone who few pages on, you are certain to enjoy on energy conservation, and Patricia contributed content to this issue of Pierre Lepage’s reflections on the orga- Morgan’s update on the Auckland Art Papyrus. I hope you enjoy learning about nization. For those of you who have Gallery building project. You will also our history, and I look forward to seeing been members of IAMFA for a few years, find an article from Stacey Wittig with you this fall in San Francisco! you may recall Guy Larocque intro- some interesting trends from the first ducing Pierre Lepage at the closing ten years of the IAMFA annual bench- Joe May Gala of the 2007 conference in Ottawa. marking exercise. Editor, Papyrus PAPYRUS SUMMER–FALL 2010 1
  • 4.
    Message from thePresident Message du prĆ©sident Mensaje del Presidente John de Lucy President / PrĆ©sident / Presidente, IAMFA San Francisco— San Francisco, Ā”San Francisco— Here We Come! on y va! Estamos en Camino! T L E he U.K. Chapter has had such a e chapitre du Royaume-Uni, j’ai l CapĆ­tulo del Reino Unido ha successful year that, I understand, entendu, a eu tellement de succĆØs experimentado tanto Ć©xito este there will be 14 members plus qu’il y aura 14 membres de plus aƱo que tengo entendido que guests attending from this side of the parmi les invitĆ©s prĆ©sents de ce cĆ“tĆ© asistirĆ”n mĆ”s de 14 miembros de este pond—an excellent turnout. Must be de l’étang – un taux de participation lado del charco a la conferencia—una something in the air! excellent. Il doit y avoir quelque chose representación excelente. Ā”Debe haber San Francisco in 2003 was my first dans l’air! algo en el aire! IAMFA conference, and Joe Brennan San Francisco en 2003 a Ć©tĆ© ma pre- La conferencia en San Francisco and his team are putting together miĆØre confĆ©rence de l’IAMFA et Joe en 2003 fue mi primera conferencia another fabulous treat for us all this Brennan et son Ć©quipe sont en oeuvre de IAMFA, y Joe Brennan y su equipo fall. The one activity I particularly pour nous faire une autre tournĆ©e fabu- estĆ”n preparando otra fabulosa experi- remember from 2003 was the California leuse cet automne. L’activitĆ© dont je encia para todos nosotros este otoƱo. BBQ in an old dairy barn on the me souviens particuliĆØrement de 2003 La actividad de 2003 que mĆ”s me trae Runnymede Sculpture Farm. I am Ć©tait le barbecue Ć  la Californie Ć  une recuerdos es la barbacoa de California delighted that we are returning there ancienne laiterie dans la Grange aux que tuvo lugar en una vieja instalación this year, so that you will be able to sculptures Runnymede. Je suis ravi que lechera de la Granja con esculturas enjoy a similar event on Monday, nous y retournions cette annĆ©e, de Runnymede. Me complace saber que October 18. This will be a unique sorte que vous aussi pourriez profiter vamos a regresar allĆ­ otra vez este aƱo experience in a private park that you d’un Ć©vĆ©nement similaire, le lundi para que Ustedes tambiĆ©n puedan cannot otherwise visit. Members and 18 octobre. Ce sera une expĆ©rience disfrutar de un evento parecido, el their guests will also have an oppor- unique dans un parc privĆ© que vous lunes 18 de octubre. SerĆ” una experi- tunity to walk together across the ne pouvez pas autrement visiter. Les encia Ćŗnica en un parque privado que Golden Gate Bridge on Wednesday membres et leurs invitĆ©s auront Ć©gale- normalmente es de acceso restringido. afternoon, enjoying stunning views of ment l’occasion de marcher ensemble Los miembros y sus invitados tendrĆ”n the city and Alcatraz. In the evening, Ć  travers le Pont Golden Gate, mercredi la oportunidad de caminar juntos a we will attend the Gala dinner at the aprĆØs-midi, profitant d’une vue impre- travĆ©s del Puente Golden Gate en la Maritime Museum with panoramic nable sur la ville et sur Alcatraz. Dans tarde del miĆ©rcoles, y disfrutar de unas views of the bay at sunset. la soirĆ©e, nous allons assister au dĆ®ner vistas impresionantes de la ciudad y de Along with these unique events, the de gala au MusĆ©e maritime avec une vue Alcatraz. Por la tarde, asistiremos a la programme is packed with behind- panoramique sur la baie au coucher comida de gala en el Museo MarĆ­timo the-scenes tours, fabulous events and du soleil. con vistas panorĆ”micas del ocaso en educational visits, making this is a con- ParallĆØlement Ć  ces Ć©vĆ©nements la bahĆ­a. ference that is not to be missed. If you uniques, le programme est emballĆ© En conjunto con estos eventos Ćŗni- haven’t looked at the proposed pro- avec des visites dans-les-coulisses, de cos, la agenda esta repleta de giras tras gramme in detail, please do so in this fabuleuses activitĆ©s et des visites Ć©du- bastidores, actividades fabulosas y visitas issue of Papyrus, or online at www.iamfa. catives, ce qui dĆ©montre qu’il s’agit educacionales, demostrĆ”ndoles asĆ­ que org/agenda2010—it is sure to entice d’une confĆ©rence Ć  ne pas manquer. no deben perderse esta conferencia. Si members and, just as importantly, Si vous n’avez pas regardĆ© le pro- no se han fijado bien en el programa, their guests. gramme proposĆ© dans le dĆ©tail, s’il por favor mĆ­renlo en este ejemplar 2 PAPYRUS SUMMER–FALL 2010
  • 5.
    Joe Brennan haschosen the dates vous plaĆ®t faites-le dans ce numĆ©ro du de Papyrus, o en la dirección en lĆ­nea to ensure fabulous weather and a full Papyrus, ou en ligne Ć  www.iamfa.org/ www.iamfa.org/agenda2010—no cabe moon (what, I wonder, is the signifi- agenda2010 – on y est sĆ»r de capturer duda que llamarĆ” la atención de los cance of that!). I know he will have l’attention des membres et, tout aussi miembros y sus invitados, quienes son something up his sleeve to surprise important, de leurs invitĆ©s. de igual importancia para nosotros. us. At our April Board meeting, the Joe Brennan a choisi les dates pour Joe Brennan ha escogido las fechas last activity on the agenda was a Sunday assurer une mĆ©tĆ©o fabuleuse avec la para que coincidan con la luna llena y morning meeting at 5:00 a.m. to wit- pleine lune (je me demande quelle est asegurarnos un tiempo fabuloso (Ā”me ness an annual ceremony marking the la signification de cela!). Je sais qu’il pregunto cuĆ”l serĆ” el significado de anniversary of the devastating 1906 aura quelque chose dans son sac pour la luna llena!) Estoy seguro que estarĆ” earthquake and fire. Joe May and I met nous surprendre. En avril, lors de la tramando algo especial para sorpren- Joe Brennan in reception at 4:45 a.m. rĆ©union du Conseil, la derniĆØre activitĆ© dernos—en la reunión de la Junta and walked to a firehouse close to the sur l’ordre du jour a Ć©tĆ© une rĆ©union Directiva de abril, la Ćŗltima actividad hotel, where sirens sounded to mark dimanche matin Ć  5h00 pour assister Ć  en el programa era una visita a las the event (I pity the poor residents of la cĆ©rĆ©monie annuelle marquant l’an- 5:00 a.m. a una ceremonia anual que surrounding hotels). We then had to niversaire de terribles tremblements conmemora el aniversario del terre- have a glass of port, and Joe Brennan de terre et feu de 1906. Joe May et moto e incendio devastadores de 1906. gave us a keepsake of a black handker- moi avons rencontrĆ© Joe Brennan Ć  la Joe May y yo nos reunimos con Joe chief covered in red and orange flames. rĆ©ception Ć  4:45 am et nous sommes Brennan en la recepción a las 4:45 a.m. This year’s conference hotel, the allĆ©s vers une caserne de pompiers Ć  y caminamos hacia una estación de Sir Francis Drake Hotel, already has proximitĆ© de l’hĆ“tel où les sirĆØnes son- bomberos cerca del hotel, donde sona- firm bookings for 40 of the allocated naient Ć  l’occasion des Ć©vĆ©nements (je ron las sirenas para marcar el evento 50 rooms available at the reduced con- suis dĆ©solĆ© pour les pauvres habitants (lo lamento por los pobres ocupantes ference rate. So, if you have not already des hĆ“tels environnants). Ensuite, il de los edificios cercanos). Luego nos booked, make sure you register soon a fallu que nous buvions un verre de tomamos una copa de vino oporto, y for one of the last 10 rooms! porto et Joe Brennan nous a donnĆ© Joe Brennan nos regaló como recuerdo Our American and Canadian col- comme souvenir un mouchoir noir un paƱuelo negro cubierto con un leagues suffered badly last year with couvert de flammes ardentes en rouge diseƱo de llamas rojas y anaranjadas. cutbacks, yet the very successful 2009 et orange. El hotel de la conferencia de este Washington conference had a record L’hĆ“tel de la confĆ©rence de cette aƱo, el Sir Francis Drake, ya tiene reser- turnout, so let’s hope this year’s con- annĆ©e, le Sir Francis Drake, a dĆ©jĆ  vaciones para 40 de los 50 cuartos ference in San Francisco can be prior- des rĆ©servations fermes pour 40 des disponibles, a los precios reducidos itized above any other conferences 50 chambres disponibles, allouĆ©es au de la conferencia. AsĆ­ que si no han you may be considering attending. If taux rĆ©duit de confĆ©rence. Donc, si reservado todavĆ­a, asegĆŗrense de reg- your boss is having trouble with the vous n’avez pas dĆ©jĆ  en rĆ©servĆ©, assurez- istrarse pronto para uno de los Ćŗltimos word ā€œconferenceā€, assure him/her vous de vous inscrire rapidement pour 10 cuartos! that this is the best training session l’un des 10 derniĆØres chambres! Nuestros colegas americanos y cana- value of the year! Nos collĆØgues amĆ©ricains et cana- dienses han pasado por tiempos difĆ­ciles The last 18 months have focused diens ont beaucoup souffert l’an este Ćŗltimo aƱo debido a recortes de our minds on matters financial—none dernier en raison des compressions presupuesto, sin embargo la asisten- more so than those related to facilities budgĆ©taires, mais l’édition trĆØs rĆ©ussie cia a la muy exitosa conferencia de management. Reducing costs and add- de la ConfĆ©rence de Washington 2009 Washington 2009 rompió record, asĆ­ ing value for money has been one way a eu un taux de participation record; que esperemos que al hacer la lista in which facilities managers have proven alors, espĆ©rons que celle de cette annĆ©e de prioridades de este aƱo le den mĆ”s their worth to organisations, particu- Ć  San Francisco puisse ĆŖtre priorisĆ©e peso a la conferencia de San Francisco larly in a time of economic crisis— au dessus d’autres confĆ©rences que que a todas las demĆ”s. Si a su super- but is it a fair picture of all that you vous envisagez assister. Si votre patron visor le incomoda la palabra ā€œconfer- as facility managers could achieve for a des problĆØmes avec le mot Ā« confĆ©- enciaā€, Ā”explĆ­quele que Ć©sta serĆ” la your cultural organisations? There are rence Ā», assurez-lui que c’est la plus sesión de entrenamiento mĆ”s valiosa opportunities ahead that we will need prĆ©cieuse session de formation de del aƱo! to address in order to continue main- l’annĆ©e! Los eventos de los Ćŗltimos 18 meses taining our vital role within our organi- Les 18 derniers mois ont portĆ© notre han enfocado nuestras mentes en sations. We need to take this changing attention sur les questions financiĆØres, asuntos financieros—sobre todo en world into account, and realign our mais plus encore sur celles liĆ©es Ć  la el caso de los relacionados con mante- roles and purpose if we wish to deliver gestion des installations. RĆ©duire les nimiento de instalaciones. Reducir sustainable value to our organisations. coĆ»ts et maximiser le cĆ“ut-bĆ©nĆ©fice costos y maximizar costo-beneficio es How are you going to improve your a Ć©tĆ© une des faƧons dont les gestion- una de las maneras en que los gerentes game? Come to San Francisco and tell naires d’installations ont pu dĆ©montrer de mantenimiento han demostrado PAPYRUS SUMMER–FALL 2010 3
  • 6.
    us, or sendJoe May an article for the leur valeur aux organisations, en par- su importancia a las organizaciones, next edition of Papyrus. ticulier en temps de crise Ć©conomique especialmente en los tiempos de crisis So, as the next generation of Facili- – mais est-ce que c’est une image fidĆØle económica—¿pero realmente es una ties Managers, are you prepared to be de tout ce que vous, en tant que ges- imagen representativa de todo lo que workplace enablers, become carbon- tionnaires d’installations, pourriez Ustedes como gerentes de mantenimi- driven, link energy to maintenance, be atteindre pour vos organisations cul- ento pudieran lograr para sus organiza- led by partnerships, invest in relations turelles? Il y a des opportunitĆ©s Ć  venir ciones culturales? Hay oportunidades with suppliers, ensure that you become auquelles nous devons faire face afin en el futuro que nos veremos obligados a Board Room item, be smart about de maintenir notre rĆ“le vital au sein a enfrentar para mantener nuestros asset transfers, be intelligent about ser- de nos organisations. Nous devons papeles crĆ­ticos dentro de nuestras vice delivery, and become integrated prendre en compte ce monde en mu- organizaciones. Necesitamos tomar en with your colleagues in HR, Finance tation et rĆ©aligner nos rĆ“les et nos cuenta este mundo que estĆ” en proceso and IT? And that’s just for starters! buts si nous voulons offrir une valeur de cambio y rediseƱar nuestros papeles durable pour nos organisations. Com- y objetivos si queremos seguir sumi- ment allez-vous amĆ©liorer votre jeu? nistrando valor sostenible a nuestras Venez Ć  San Francisco et dites-nous organizaciones. ĀæCómo pueden mejorar This conference will ou envoyez Ć  Joe May un article pour sus estrategias de juego? Vengan a provide an opportunity sa prochaine Ć©dition du Papyrus. San Francisco y dĆ­gannos, o mĆ”ndenle Donc, comme la prochaine gĆ©nĆ©ra- un artĆ­culo a Joe May para su próxima to exchange ideas and tion des gestionnaires d’installations, edición de Papyrus. ĆŖtes-vous prĆŖt Ć : dynamiser le milieu AsĆ­ que, como la próxima generación develop a learning de travail, devenir un Ā« conducteur-Ć - de gerentes de mantenimiento, estĆ”n partnership . . . carbon Ā», lier l’énergie vers l’entretien, Ustedes preparados para: ser capaci- ĆŖtre guiĆ© par des partenariats, investir tadores del lugar de trabajo, tomar dans les relations avec les fournisseurs, decisiones en Āæbase del manejo de la Cette confĆ©rence sera veiller Ć  ce que vous devenez un Ć©lĆ©- huella de carbono? ligar la energĆ­a al l’occasion d’échanger des ment discutĆ© par le Conseil, ĆŖtre Ć  mantenimiento, ser guiados por equipos puce sur les transferts d’actifs, ĆŖtre de trabajo, invertir en relaciones con idĆ©es et de dĆ©velopper un intelligent sur la prestation des services los proveedores, asegurar que sus metas et vous intĆ©grer avec vos collĆØgues des formen parte de la agenda de la Junta partenariat Ć©ducatif . . . ressources humaines, des finances et Directiva, saber llevar a cabo las trans- des TI? Et ce n’est qu’un dĆ©but! ferencias de bienes con inteligencia, Esta conferencia nos Au Royaume-Uni, le nouveau gou- optimizar el plan de suministros, e vernement de coalition a annoncĆ© une integrarse con sus colegas de Recursos brindarĆ” la oportunidad rĆ©duction minimale prĆ©vue de 25 % Humanos, Finanza, e InformĆ”tica? Ā”Y dans les budgets de toutes les institu- todo esto es solamente el comienzo! de intercambiar ideas y tions culturelles; nous sommes donc En el Reino Unido, el nuevo desarrollar un equipo confrontĆ©s Ć  rĆ©flĆ©chir sur la faƧon dont gobierno de coalición ha anunciado nous offrons nos services avec une que prevĆ© un recorte del 25% mĆ­nimo de aprendizaje . . . rĆ©duction importante des ressources de todos los presupuestos de las insti- financiĆØres. Profitez de cette occasion tuciones culturales, asĆ­ que nos vemos Ć  la confĆ©rence pour aider vos cousins forzados a enfocarnos en cómo pode- In the U.K., the new coalition gov- du Royaume-Uni avec les expĆ©riences et mos suministrar nuestros servicios con ernment has announced an intended les idĆ©es novatrices que vous avez trou- una reducción realmente significativa minimum 25% cut in the budgets of vĆ©es! Voyons comment nos membres de los recursos financieros. Aprove- all cultural institutions, so we are faced ont rĆ©ussi Ć  maintenir les services dans chen esta conferencia para ayudar a with having to think hard about how we un environnement de rĆ©duction sĆ©vĆØre sus primos del Reino Unido con las deliver our services with a major reduc- des coĆ»ts. experiencias e ideas innovadoras exi- tion in financial resources. Do use this Je crains que notre gouvernement tosas que han descubierto! Discutamos conference opportunity to help your pourrait essayer de fusionner nos insti- cómo nuestros miembros han logrado U.K. cousins with the experiences and tutions afin de rĆ©duire le nombre de seguir suministrando servicios en innovative ideas you have found that musĆ©es individuels. Quelqu’un d’entre un contexto de reducciones severas work! Let’s discuss how our members vous a eu cette expĆ©rience dans votre de costos. have managed to keep services going in propre pays? Le ministĆØre britannique Temo que nuestro gobierno intente an environment of severe cost reduction. de la Culture, des MĆ©dias et du Sport unir a nuestras instituciones para redu- I am apprehensive that our govern- a demandĆ© des prĆ©cisions sur toutes cir la cantidad de museos individuales. ment might try to amalgamate our les dates de la fin de nos contrats indi- ĀæAlguno de Ustedes ha experimentado CONTINUED ON PAGE 29 SUITE ƀ LA PAGE 29 SIGUE EN LA PƁGINA 29 4 PAPYRUS SUMMER–FALL 2010
  • 8.
    IAMFA . .. The First Twenty Years 2 010 marks the twentieth anni- attend the meeting, but had no idea Washington, D.C. —1991 versary of IAMFA, and our what to expect. At the time, Vinny was Greg Reynolds was in charge of mak- San Francisco conference host a member of the Building Owners and ing preparations for this inaugural Joe Brennan thought it fitting that we Managers Association (BOMA) and IAMFA conference, with help from publish an article about the Associa- remembers that, while BOMA did colleagues at other local museums. tion’s history. Many of us have been provide the means to keep abreast of What was obvious at this first IAMFA members of IAMFA for years, but I changes in technology, it was geared conference was that the early members think most would agree that we really more toward commercial buildings. This were very eager to share their ideas. don’t know exactly how IAMFA came left him feeling that he needed more. Included were educational sessions into existence. Fortunately, there are The host of the meeting in Chicago still active members who were present was George Preston, who was Facilities during those initial years, and they have Director at the Art Institute. He was a helped us document IAMFA’s history. large man—not just physically, but intel- One of these individuals is Vincent lectually—and he was very determined. Magorrian, who is the retired Facilities George believed that this group could Director for the Museum of Modern organize and become the first true Art in New York City. Vinny is a charter museum facilities organization. All member of IAMFA, and also served as of the individuals in attendance intro- President of IAMFA during the Asso- duced themselves, and spoke about ciation’s early years. Please read on to their own institutions, then collectively learn more about IAMFA’s history. spent a lot of time brainstorming about what kind of organization they could be. Above all, George wanted to charter Chicago —1990 the organization, and he wanted bylaws In 1990, Vinny Magorrian received like APPA (the Association of Physical an invitation from the Art Institute Plant Administrators). From the first of Chicago to attend a meeting in day, George worked to establish bylaws; Chicago, along with representatives and if George wanted to accomplish The National Gallery of Art in Washington, from other museums. He decided to something, he did. D.C. The Art Institute of Chicago. The individuals at this first meeting in Chicago decided that their next meeting would be in Washington, From an early IAMFA meeting. Front left: Vinny Magorrian; right: D.C., and in the year leading up to that meeting, IAMFA was Ron Puska; back centre: Myro Resnick. The two others are incorporated as a not-for-profit organization. unknown. 6 PAPYRUS SUMMER–FALL 2010
  • 9.
    focusing on museumenvironmental IAMFA wanted to grow interna- everyone always shared problems (and requirements, and conference organi- tionally, and our first success was with solutions) from their institutions. It zers invited guests from other museum Canada. The Canadians were very inter- seemed that technology was advancing departments to discuss what facilities ested in having a museum facilities so fast that, if you missed these sessions, departments did to achieve optimal organization, and it is likely that, with- you could be left behind. Members environmental conditions. There were out their help, we would not have grown also decided at this meeting that they vendors who made presentations, into the organization that we are today. would volunteer to make a presenta- as well as conservators and curators. We had our second annual banquet, tion at the American Association of According to Vinny, this was the begin- which became the traditional closing Museums annual conference. ning of our becoming professional in of the conference; in future we would the eyes of directors, curators, and call it a Gala, and it truly was every year. conservators. The attendees visited Kansas City was the first meeting Toronto —1994 several local museums for behind-the- attended by Peter Fotheringham, who Our next meeting was hosted by the Art scenes tours, and enjoyed sessions dur- at the time was Facility Director at the Gallery of Ontario and Ron Yurchuck. ing which curatorial members explained National Gallery in Scotland. Peter This was the first time IAMFA included works of art through their eyes. would go on to host a conference, and vendor displays the night before the later became IAMFA’s President. Peter annual general meeting. A few vendors remembers the friendly coercion that had become members by this time, and Kansas City—1992 they made presentations at the confer- went into his accepting the 1998 con- The following year, the IAMFA confer- ence, but were always careful to focus ference date for Edinburgh, but he ence was hosted at the Nelson-Atkins on educational content, rather than was delighted to do it, having been Museum of Art, and began with a sales. We were progressing as an orga- warmly welcomed by everyone in Kansas general session as it did in subsequent nization. We discussed problems expe- City. With Canadian members now— conferences. Members reviewed meet- rienced by Russian museums at the and with Peter, who soon attracted ing minutes and introduced the Board time, and discussed sending IAMFA individuals from other European coun- of Directors to attendees. We learned in delegates to Russia to offer our support. tries—we began gaining recognition Kansas City that everyone who attended At the closing banquet, there were two as a growing museum organization. needed to have a hand in the confer- members—Mark DeMairo and Marty ence if we were to be successful. We Cavanaugh—from the New York City went on to have educational sessions Cincinnati—1993 delegation who were away from their in areas such as controls, codes and In 1993, we were hosted by the Cincin- table for a few minutes. When they regulations, curatorial-defined differ- nati Museum Center at Union Terminal. returned, they found out that they ences required for different art media, It was a museum centre composed had volunteered to host the next and many others. We also planned free of several museums. It was a history year’s conference! time so we could network with each museum, a science museum, and a other, and began to set up focus groups. children’s museum, and it also had an It was challenging, as we were just OMNIMAXĀ® Theater. This was Vinny New York—1996 starting to grow. We met for breakfast, Magorrian’s first year as IAMFA’s When it sank in that New York City and visited various museum facilities, President. George Preston, IAMFA’s would be the next conference host, which would become our custom in founder, had retired by now. As usual, the chapter began monthly meetings, future conferences. We observed that we began with our general meeting, according to Vinny Magorrian. With by doing this, our membership began then split into educational groups— Marty Cavanaugh, Myro Resnick, and to expand. which were really sharing groups, as Mark DeMairo, they worked together The Nelson-Atkins Museum of Art in The Cincinnati Museum Center at Union The Art Gallery of Ontario in Toronto, Kansas City, Missouri. Terminal in Cincinnati, Ohio. Canada, following renovations completed in 2009. PAPYRUS SUMMER–FALL 2010 7
  • 10.
    to develop aprogram, and began to did that thinking it would give them we visited too, but the Getty Center schedule speakers and solicit support the true feeling of an opening. was overwhelming in its grandeur. from member facilities. The banquet The highlight for many during the This was the first year awards were was to be held at the Guggenheim, April 1996 conference was a boat trip presented at the Gala; and the first and our meeting would be at Doral to Ellis Island. It was amazing to walk presented was the George Preston Hotel in Manhattan, with visits to the halls where so many came to the Memorial Award. It was presented to various museums. United States. But it was also eerie as Ron Puska, who had served in several Peter Fotheringham made a pre- members went to areas not open to capacities within IAMFA, and who was sentation about emergency prepared- the public, such as hospital rooms with always willing to offer his time to the ness, in which he related events at the a single light bulb, and crumbling walls. organization. Vinny Magorrian was National Gallery and an attack with According to Vinny, you could feel the proud to receive ā€œThe Member of the explosives by the IRA, as well as collec- hurt of those who were sent back to Year Awardā€, which Vinny thinks Mark tion storage practices in salt mines dur- their original countries because of DeMairo had something to do with. ing the Second World War. There was illness; the most common cause being Maybe the time will come soon to a major opening of Matisse’s work at pink eye, which is so easily treated resurrect the George Preston Award? the Museum of Modern Art (MOMA), now. Vinny remembers feeling many Without George, there would be no and Vinny got tickets for attendees; emotions while visiting those areas IAMFA. George was a mentor, and a however, he reports that he is still in where families were broken up, and felt driving force in establishing IAMFA, trouble with his wife and others for he was changed from then on. The and he always pushed the officers to having them wait in line, and says he team shared a sense of pride for the make IAMFA better. success of the New York conference. Edinburgh, Scotland —1998 Los Angeles—1997 Our next IAMFA annual conference Our next conference was held at the was held in Edinburgh, and was hosted Getty Center, which was still under by Robert Galbraith, with help from construction in Los Angeles at the Peter Fotheringham. Peter had agreed time. It was a beautiful site, and mas- to host the 1998 conference while in sive, and knowing that there was not Kansas City, but moved to the National really a budget made us all envious. Gallery in London in 1994, leaving The host was Lloyd Randolph. We Robert with the responsibility! The con- also visited the Old Getty Museum in ference in Edinburgh was a big step Malibu, and celebrated Cinco de for IAMFA, as we now had a presence Mayo at the Museum of Contempo- in Europe. In the year leading up to rary Art. There were other museums the May 10–13, 1998 conference in The Museum of Modern Art in New York City. The Guggenheim Museum in New York City. The new Getty Center in Los Angeles. 8 PAPYRUS SUMMER–FALL 2010
  • 11.
    Edinburgh, Pierre Lepageconducted and, above all, we were now a truly inter- Randolph found out that the Buffalo a year-long benchmarking survey with national organization. Following the Bill Museum Center in Cody, Wyoming, 66 museums, and presented the results Edinburgh conference IAMFA mem- which was to have hosted the confer- at the Edinburgh conference. It was bers, along with Ian Follett’s company, ence in 1999, could not do it due to then that a proposal was made for Facility Management Services, Ltd. spent delays with their museum construction IAMFA to support this activity as an nearly two years developing the first project. Pierre Lepage was asked if he ongoing endeavor. The Edinburgh formal benchmarking questionnaire could chair the conference in Ottawa- conference was a great one. We visited of 89 questions. Gatineau—with a year to prepare. The Edinburgh Castle and viewed the crown conference organization committee jewels of Scotland, and even had bag- included Pierre Lepage of the Canadian pipers at the Gala, which was truly fit Ottawa, Canada—1999 Museum of Civilization and Canadian for a king. The sessions were informa- During the 1998 conference in War Museum, Jim Trim of the National tive, we all learned from one another Edinburgh, IAMFA President Lloyd Gallery of Canada, Carole Beauvais of the National Archives and Library of Canada, Gerry Potoczny of the Cana- dian Museum of Nature, and Toby Greenbaum of Public Works Canada historic properties. Conference participants and their spouses stayed at the Chateau Laurier, a historic landmark in Ottawa next to Parliament Hill. The welcoming recep- tion took place at the Chateau Laurier on the Sunday evening, and the con- ference sessions were hosted at the Museum of Nature, the National Gallery of Canada, the newly opened National Archives facility, and the Canadian Museum of Civilization, where the closing ceremonies and Gala were hosted. During the conference, there was an evening dinner in the restau- rant of the House of Commons on Parliament Hill, with the Minister of Public Works Canada as keynote Edinburgh Castle. speaker. The guest program included a day trip to Upper Canada Village on the St. Lawrence Seaway: a sixty-acre HARRY FOSTER, CMC historical site with forty heritage build- ings, where one can experience the traditional life of the mid-nineteenth century. Guests also enjoyed a tradi- tional afternoon tea on the Mackenzie King Estate in Gatineau Park. It was a very successful conference, with splendid weather and lots of sun for this May event held on both sides of the Ottawa River. Chicago—2000 Our next conference was held in Chicago at the Art Institute, and our host was Bill Caddick. There were many highlights at the Chicago conference, including a speakeasy gangster dinner, The Canadian Museum of Civilization from the opposite side of the Ottawa River. The a river tour, drinks atop the Hancock domed building contains the public galleries; to its right is the curatorial and administrative Building, and the Tutankhamun Exhi- building, which also houses all collection storage. bition. Bill Caddick went on to become PAPYRUS SUMMER–FALL 2010 9
  • 12.
    United Kingdom Washington, D.C./Baltimore Washington, D.C.—2001 The Washington, D.C. conference was originally scheduled for September 2001, but was cancelled due to 9/11. The Committee, led by Fletcher Johnston and coordinated by Marla Chanin Tobar (now Marla Neustadt), The Field Museum: one of the featured sites faced a challenge: reorganize and The Natural History Museum in Washington, of the 2000 IAMFA annual conference. reschedule all the arrangements, or D.C. during the 2001 IAMFA conference. let the D.C. conference slip away. The IAMFA’s President in 2002. Regional choice was to pull ourselves up by the the first benchmarking exercise were chapters were formally established at the bootstraps—as many others did in the presented to participating members on IAMFA annual conference in Chicago wake of 9/11—and put together another Sunday, December 2, 2001. Today, this in September 2000. amazing program for December 2–5. valuable exercise is in its tenth year. Over the years, regional chapters An Indian summer welcomed members were founded in metropolitan areas to to tours, the benchmarking workshop, educational sessions, and festivities at London—2002 give local members an opportunity to meet on their own, both to learn from the Smithsonian, Meridian International Peter Fotheringham was the organizer one another and to network. Regional Center, and the Holocaust Museum, of the 2002 London conference. This chapters have become effective forums among others, and an infamous clos- was Peter’s final year as President of for the exchange of information among ing Gala at the National Gallery of Art. IAMFA, and Bill Caddick from the local members, while also attracting IAMFA’s members showed their resi- Art Institute of Chicago was elected non-members and encouraging them lience and spirit by absorbing the impact new President during the conference. to join our organization. Today, IAMFA of 9/11 and rallying to attend the D.C. The program spanned three days, has 13 local chapters, located in: conference in December. The results of and included the National Gallery, the British Museum, and the British Library. Atlanta Pierre Lepage recalls the meeting as Australia being a very informative one and, Bilbao, Spain among other things, remembers the Chicago stunning new geodesic dome over the Los Angeles British Museum’s inner court and New England library, as well as a presentation on New York City operations and maintenance at the New Zealand British Library’s new St. Pancras com- Ottawa-Gatineau, Canada plex. We visited the newly opened Tate Philadelphia Recent meeting of the Washington, Modern Gallery, and learned about San Francisco D.C./Baltimore Chapter. lighting and natural light control at Recent meeting of the U.K. Chapter in Liverpool. Philadelphia Chapter members meeting at the Winterthur Museum and Country Estate in nearby Delaware. 10 PAPYRUS SUMMER–FALL 2010
  • 13.
    Boston—2004 The 2004 conference was held in Boston, Massachusetts. Jim Moisson led this incredible effort. A hotel room had been booked for vendors to display their products and services. We toured Boston Harbor by boat, and visited the Isabella Stewart Gardner Museum— known as the site of the biggest art theft in history. Shortly after midnight The British Library during the 2002 IAMFA on the morning of March 18, 1990, The Fogg Museum of Art at Harvard conference in London. thieves disguised as police officers University in Boston, Massachusetts. talked their way into the Museum. They handcuffed the two security the National Gallery. A highlight for guards on duty and stowed them sentations from the architects and many was the bus trip to the conference out of sight, then stole 13 works of engineers responsible for design and dinner in a Routemaster Bus: the art valued at over $500 million. The construction of the Guggenheim, itself traditional London doubledecker. crime still remains unsolved. a fabulous work of art. In addition to We visited the Boston Athenaeum, our annual general meeting, we also had a brainstorming session aimed at San Francisco—2003 had lunch at the Union Club, then walked across Boston Common. We shaping future strategy for IAMFA, and The conference in San Francisco was we will do this again in San Francisco Joe May’s first, and he says he knew learned about LED lighting at this conference, and at the 2010 confer- this fall at the 2010 IAMFA conference. by the end of the conference that he We visited the Maritime Museum, the wanted to become an active member ence in San Francisco, LSI Lighting will once again make a presentation Fine Arts Museum and Old Town, and of IAMFA. There was a presentation we heard from Pat Morgan on plans on security requirements in the post- on new developments in LED lighting. We visited the Museum of Fine Arts, for the redevelopment project at the 9/11 era, and on base isolation as a Auckland Art Gallery Toi o TĀÆ maki a means of protecting buildings in seis- and the Peabody Essex Museum. Guy Larocque was elected the next IAMFA in New Zealand. We’ll see this project mically active areas. We visited the firsthand in the fall of 2011 when deYoung Museum—then still under President in Boston, and he went on to become our longest-serving President. New Zealand hosts the 21st IAMFA construction—to see a base isolation conference, and you can read more system being installed, and we will be One big question from the Boston con- ference was whether the lobster boil about recent developments in this visiting the deYoung again during the issue of Papyrus. We headed into the 2010 IAMFA conference. We visited in the countryside was the highlight of the conference, or whether it was Spanish countryside for dinner, and the Cable Car Museum, had lunch at heard about the Getty Center’s recent Fisherman’s Wharf, and travelled by the Fogg Museum of Art at Harvard University for the Gala. Both were LEED-EB Certification, as well as the boat to Alcatraz Island. We visited the British Library’s plans to build a low- Aquarium in its last months, prior to amazing! oxygen storage facility near York. His- the site being cleared for construction tory has shown that we’ve often had of the New California Academy of Bilbao, Spain—2005 opportunities to visit places we’ve Sciences. We visited SFMOMA and IAMFA’s 2005 annual conference was heard about in IAMFA conference other institutions in San Francisco. held in Bilbao, Spain. We heard pre- presentations. Joe also remembers that the Legion of Honor, where the conference Gala was held, was the most elegant setting he had ever seen. The Legion of Honor, site of the closing Gala for the 2003 conference in San Francisco. The Guggenheim Museum in Bilbao, Spain. PAPYRUS SUMMER–FALL 2010 11
  • 14.
    Los Angeles—2006 the Canada Aviation Museum, and British Museum, the National Gallery, In 2006, the conference was held the Canadian War Museum. We had the British Library, the Maritime in Los Angeles at the Getty Villa and dinner one evening at the l’OrĆ©e du Museum and Royal Observatory and Center, the LA County Museum of bois Restaurant in the countryside. We the Natural History Museum. The Art (LACMA), the Museum of Con- stayed next door to Parliament Hill at conference reception was held in the temporary Art (MOCA), the Disney the Chateau Laurier Hotel. We learned King’s Library at the British Museum Concert Hall, the Petersen Auto- about fire-suppression systems, micro- and, following the opening program, motive Museum, and the Japanese climate displays, preparing for redevel- we wandered through the dimly lit American Art Museum. Guests also opment programs, maintenance issues galleries to see such exhibits as the visited Universal Studios and the today and tomorrow, and the Library of Rosetta Stone and the Elgin Marbles. Reagan Presidential Library. We heard Congress’s new Audio Visual Center, It was a great kick-off to a memorable presentations on the renovation pro- which we would have the opportunity conference. We attended presentations ject at the Getty Villa (the predecessor to visit in 2009. The conference closed focusing on several themes, including of the Getty Center), building com- with a very elegant Gala Dinner at the energy savings and performance audits, missioning, fire-protection strategies, Canadian Museum of Civilization. facilities management and contracts, and an FBI agent discussed art theft During 2007, we also saw Papyrus capital projects, and climate change. issues that museums face. We heard printed in full color for the first time. This year, the conference was extended presentations on LACMA’s construc- an optional fourth day, and members tion program, and the Smithsonian’s London—2008 and guests traveled by rail to York to new asset management system, and In 2008, we met in London for the visit the new British Library low-oxygen cruised Marina Del Rey for dinner, IAMFA conference hosted by the storage facility. We also traveled down complete with a rumored marriage proposal at dinner (sorry, no update available). We toured MOCA and the Disney Concert Hall, which is another Frank Gehry design (as was the Guggen- heim in Bilbao). Facility Issues Inc., led by Keith McClanahan, took over this year as facilitator of the museum benchmarking exercise. Ottawa-Gatineau, Canada—2007 In 2007 we met in Ottawa-Gatineau, where we visited the National Gallery, the Canadian Museum of Civilization, the Library Archives Canada Gatineau Preservation Centre, the Canada The closing Gala of the 2008 IAMFA conference in London, held in the Earth Gallery at the Science and Technology Museum, Natural History Museum. Members and guests at the Getty Center during the 2006 IAMFA Members and guests on the plaza at the Canadian Museum of conference. Civilization during the 2007 IAMFA conference. 12 PAPYRUS SUMMER–FALL 2010
  • 15.
    the Thames byboat to Greenwich, We visited war memorials and monu- the United States. This year the confer- where we walked the Meridian Line ments at night under a full moon. This ence was extended an optional fourth and attended a presentation in the year, guests visited Baltimore while mem- day again, with a visit to the new Library Peter Harrison Planetarium. Refresh- bers attended the Sunday benchmarking of Congress National Audiovisual Con- ments afterward were at the Trafalgar workshop at the Baltimore Museum servation Center in Virginia. Follow- Pub, a well-known institution where of Art, hosted by Alan Dirican. During ing lunch at a winery, we visited the we all enjoyed a pint or two. Confer- their visit, guests were given guided Smithsonian Institution’s Air and ence guests had a very busy agenda, tours by BMA Director Doreen Bolger Space Museum near Dulles Airport. including a visit to the Tower of of the exhibitions Edgar Allan Poe: A During 2009, Papyrus was given London, a private meeting with the Baltimore Icon and Matisse as Printmaker. another facelift, becoming more like a Queen’s Jeweller, a viewing of the crown They also visited the Baltimore Aquar- magazine, and members increasingly jewels, a visit to Kensington Palace— ium. The opening ceremony was held contributed content. and with numerous other activities, at the Donald W. Reynolds Center, and there was still ample time to shop the first full day began with breakfast London! The 2008 conference at the National Gallery of Art, where T hese were our first twenty years culminated with a very memorable we heard a summary of the museum of IAMFA—and IAMFA has now closing Gala in the Earth Gallery at benchmarking exercise, which also set grown to more than 200 members the Natural History Museum. John a record for participation. We heard in eight countries. de Lucy was elected President at the presentations on building automation But . . . where in the world will annual business meeting during the systems, sustainability, budget planning IAMFA go next? London conference. and reliability-centered maintenance. In 2008, IAMFA also became an We visited the National Museum of Affiliated Association of the International the American Indian, which was in the San Francisco—2010 Council of Museums (ICOM). process of applying for LEED Certifica- We will be meeting in San Francisco tion. We toured the Library of Congress, on October 17–20, 2010. You can read Washington, D.C.—2009 the National Archives Building, and the more about the upcoming conference In 2009, IAMFA members met in new Capitol Visitor Center, as well as in this issue of Papyrus. See you there! Washington, D.C., attending venues the oldest Smithsonian Building, The in both Washington and Baltimore. Castle. The closing Gala was held in Nancy Bechtol was our host, and we set the Thomas Jefferson Building of the attendance records again this year, just Library of Congress, which contains as we had the previous year in London. some of the richest public interiors in The New LEED Platinum California Academy of Sciences in San Francisco. Auckland, New Zealand— 2011 The 2011 IAMFA conference will be held The closing Gala for the most recent IAMFA annual conference was held in the Great Hall of in Auckland, New Zealand on November the Library of Congress Thomas Jefferson Building in Washington, D.C. in November 2009. 13–17, 2011. PAPYRUS SUMMER–FALL 2010 13
  • 16.
    Mid-Atlantic, U.S.—2012 We believe doing so will allow our From Pierre Lepage, the original members to be better educated and editor of IAMFA’s Papyrus publication, better equipped to serve the mission ā€œThis Association has taken a quantum of their institutions. leap in the development of its annual In pursuit of these goals, the associa- conferences. The change of location tion sponsors an annual conference, and each year creates tremendous potential communicates quarterly with its mem- for conference organizers to diversify bership and friends around the world conference activities, making each through the IAMFA journal Papyrus. conference unique and memorable. For the organizers, it also becomes a Membership and truly collegial experience, giving mem- bers of the organizing committee an Educational Benefits, opportunity to work closely with one The 2012 IAMFA conference is set for Annual Meeting and the U.S. Eastern Seaboard, including another during the two years it takes the Winterthur Garden and Museum in Conference to prepare for the event. The confer- Delaware. IAMFA brings museum facility adminis- ence is also an opportunity to show- trators together to promote creativity case the best cultural institutions in the Boston—2013 and foster dialogue within the interna- host city. In addition, participants get tional museum community, in order an unequalled chance to learn from to better serve the missions and goals colleagues about different management of all museums and cultural organi- approaches, to witness progress on con- zations. Member museums host the struction sites, and to find out about annual conference, which includes successes with recent museum renova- seminars, meetings, roundtable dis- tions and museum-related construction cussions and panels on topics chosen projects around the world.ā€ by the membership. These educational sessions draw upon the knowledge and Contributors: talents of many well-respected experts John Castle, Director, Facility Services, in their fields. The variety of host cities Winterthur Museum & Garden, Winterthur, and facilities affords members the Delaware, U.S.A. The 2013 IAMFA conference is planned opportunity to see, experience and Daniel Davies, Zone Facilities Manager, for Boston, Massachusetts. learn from the world’s most renowned National Zoo, Washington, D.C. cultural institutions. Sponsorship from John de Lucy, Head of Estates & Facilities, IAMFA Statement of the businesses that provide support to British Library, London Purpose our museums, along with an oppor- Peter Fotheringham, Head of Estates, The International Association of tunity to see their latest products and University of Greenwich, London Museum Facility Administrators is an technologies, round out the Guy Larocque, Director, Facility international educational organization conference experience for members. Management and Security Services, Canadian Museum of Civilization devoted to meeting the professional According to John Castle, current Corporation, Ottawa-Gatineau, Canada needs of museum facility administra- Vice-President of IAMFA Regional Pierre Lepage (retired), Canadian Museum tors—especially their efforts to set and Affairs, ā€œOne of the great things that I of Civilization Corporation, maintain standards of excellence and love about IAMFA is that each year it Ottawa/Gatineau, Canada quality in the design, construction, holds an annual conference where up Vincent Magorrian (retired), Museum operation and maintenance of world- to a hundred delegates plus their guests of Modern Art, New York City class cultural facilities. meet in one of the world’s great cities Joe May, Sustainability Engineer, IAMFA earnestly desires to promote to share their experiences of managing Los Angeles and foster communications between the hard and soft facilities services in Marla Neustadt, Operational Support facilities professionals at museums some of the most iconic institutions in Services, NASA Headquarters, as well as other cultural facilities. the world.ā€ Washington, D.C. Become a Member of IAMFA For more information on becoming a member of the International Association of Museum Facility Administrators, please visit WWW.IAMFA.ORG 14 PAPYRUS SUMMER–FALL 2010
  • 17.
    The Twentieth AnnualIAMFA Conference in San Francisco La VingtiĆØme ConfĆ©rence de l’IAMFA Ć  San Francisco La VigĆ©sima Conferencia Anual de IAMFA en San Francisco T L E he 2010 IAMFA San Francisco ’équipe de la ConfĆ©rence de l equipo de trabajo de la con- conference team looks forward l’IAMFA Ć  San Francisco se rĆ©jouit ferencia anual de IAMFA del to welcoming all IAMFA members d’accueillir tous les membres et 2010 en San Francisco estĆ”n con and guests to the Twentieth Annual leurs invitĆ©s Ć  la 20iĆØme assemblĆ©e ganas de darle la bienvenida a la vigĆ©- IAMFA Conference. Everyone involved annuelle. Tous les participants ont sima conferencia anual de IAMFA has worked hard to develop a program travaillĆ© fort pour dĆ©velopper un pro- en San Francisco. Todas las personas packed with educational content, tours, gramme riche en contenu Ć©ducatif, involucradas han trabajado duro para and networking opportunities that you des visites guidĆ©es et des possibilitĆ©s de desarrollar un programa repleto de will be able to use in managing your rĆ©seautage que vous seriez en mesure contenido educacional, giras, y opor- facility. And the city of San Francisco d’utiliser dans la gestion de votre Ć©ta- tunidades para trabajar en las redes offers a stunning setting that is virtually blissement. Et la ville de San Francisco de contactos que podrĆ”n utilizar para unrivaled in the wealth of its cultural offre un cadre somptueux qui est pra- la administración de su instalación. institutions. tiquement inĆ©galisĆ© dans la richesse Y la ciudad de San Francisco ofrece The members’ program includes de ses institutions culturelles. un entorno increĆ­ble con un nĆŗmero numerous presentations on topics in Le programme des membres inclut infinito de instituciones culturales casi which you have expressed an interest, de nombreuses prĆ©sentations sur des sin igual. including: sujets dans lesquels vous avez exprimĆ© El programa de los miembros incluye un intĆ©rĆŖt; notamment: numerosas presentaciones sobre temas • LED Lighting in the Museum en los cuales Ustedes han demostrado Environment • L’utilisation d’éclairage LED dans un interĆ©s, incluyendo: • Seismic Resistance and the History les musĆ©es of the Cantor Arts Center • el uso de luces LED en los museos • RĆ©sistance sĆ©ismique et l’histoire • Forward Planning: IAMFA’s Next du Centre d’arts Cantor • la resistencia sĆ­smica y la historia Five Years del Centro de Artes Cantor • Planification du future: l’IAMFA • The de Young Museum: Five Years dans les cinq prochaines annĆ©es • planificación para El Futuro: los of Lessons Learned próximos cinco aƱos de IAMFA • Le musĆ©e de Young : cinq ans de • Summary of the 2010 Benchmarking leƧons apprises • el Museo de De Young: cinco aƱos and Best Practices Exercise • RĆ©sumĆ© de l’analyse comparative de lecciones aprendidas • Green Historic Preservation: The 2010 et les meilleures pratiques de Mint Project • resumen del ejercicio de 2010 de l’exercise du ā€˜Benchmarking’ evaluación comparativa (bench- • Operating a LEED Platinum • PrĆ©servation historique orientĆ©e marking) y mejores prĆ”cticas del Building au dĆ©veloppement soutenable: le ejercicio • Annual IAMFA Business Meeting projet Mint • la preservación histórica orientada • Innovation in the Exploratorium’s • Fonctionnement d’un bĆ¢timent al desarrollo sostenible: el proyecto New Plans LEED Platine Mint PAPYRUS SUMMER–FALL 2010 15
  • 18.
    • Award-Winning HistoricalPreser- • AssemblĆ© annuelle des affaires de • la operación de un edificio LEED vation—The Walt Disney Family l’IAMFA platino Museum • Innovation dans les nouveaux plans • reunión anual de IAMFA de de l’Exploratorium planificación A range of fascinating behind-the- scenes and gallery tours are also on • Prix gagnĆ© pour prĆ©servation histo- • innovación en los nuevos planos the agenda, along with a great guest rique – le MusĆ©e de la Famille de del Exploratorium program. This year’s conference venues, Walt Disney • un ejemplo de preservación histórica in and around San Francisco, are ganador de premio—el Museo de described below. Une gamme fascinante de tournĆ©es La Familia de Walt Disney Ā« dans-les-coulisses Ā» et de visites gui- San Francisco Museum dĆ©es sont Ć©galement dans l’itinĆ©raire, Una gama de giras fascinantes tras of Modern Art avec un programme excellent pour bastidores y de galerĆ­as tambiĆ©n estĆ” en The San Francisco Museum of Modern nos hĆ“tes. Les lieux de rendez-vous Ć  el itinerario, ademĆ”s de un programa Art celebrated its 75th anniversary in l’intĆ©rieur et autour de San Francisco excelente para los invitados. Los en- January 2010 (now, doesn’t that sound pendant la confĆ©rence de cette annĆ©e sont dĆ©crits ensuite, ci-dessous. tornos de la conferencia de este aƱo, like an oxymoron: Modern and 75 dentro de y alrededor de San Francisco, years?). The Museum was originally se describen a continuación. housed in the War Memorial Building Le MusĆ©e d’art moderne in the Civic Center across the street de San Francisco El Museo de Arte Moderno from City Hall, sharing the building Le MusĆ©e d’art moderne de San de San Francisco with veterans’ organizations and the Francisco a cĆ©lĆ©brĆ© son 75e anniver- Herbst Theater. When it opened its saire en janvier 2010 (Ƨa ne sonne El Museo de Arte Moderno de San doors in January 1935, it was consid- pas comme un oxymoron: moderne Francisco celebró su 75a aniversario ered a pioneer in the field of modern et 75 ans?). Le musĆ©e fut installĆ© dans en enero 2010 (Āæno suena un poco art collection and display. It also had l’édifice commĆ©moratif de la guerre contradictorio los tĆ©rminos moderno one of the first photography collections dans le Centre civique en face de y 75 aƱos?). Originalmente el Museo in the museum world, acknowledging l’HĆ“tel de ville, partageant le bĆ¢timent se encontraba en el Edificio Conme- photography as an art form well before avec des organisations d’anciens com- morativo de la Guerra en el Centro many of its contemporaries. battants et le Théâtre Herbst. Lorsqu’il CĆ­vico en frente del Ayuntamiento, y By the 1980s, the Museum had out- a ouvert ses portes en janvier 1935, il compartĆ­a el edificio con las organiza- grown its original quarters, and planning a Ć©tĆ© considĆ©rĆ© comme un pionnier ciones de los veteranos de las guerras began for a new purpose-built facility. dans le domaine de la collection d’art y el Teatro Herbst. Cuando abrió sus Architect Mario Botta was selected to moderne et d’affichage. Il Ć©tait Ć©gale- puertas en enero de 1935, se lo con- design the signature building on Third ment l’une de premiĆØres collections sideró un pionero en el campo de la colección y la exhibición de arte moderno. TambiĆ©n a travĆ©s de una de las primeras exhibiciones de foto- HENRIK KAM grafĆ­as en el mundo de los museos, reconoció a la fotografĆ­a como arte antes que muchos de los otros museos. Para los 1980s, el Museo habĆ­a cre- cido demasiado para su alojamiento original y se comenzó a planear una nueva instalación construida expresa- mente para museo. El arquitecto Mario Botta fue seleccionado para diseƱar el edificio Ćŗnico en la calle tercera., al sur de la calle Market. Para algunos miembros de la sociedad de San Francisco, esta idea les pareció herejĆ­a, no era aceptable ir al ā€œsur de la ranuraā€ (ā€œla ranuraā€ se referĆ­a a la ranura en la calle para el tranvĆ­a) Sin embargo, la selección de este vecin- dario resultó visionaria, ya que este Ć”rea al sur de la calle Market estaba The San Francisco Museum of Modern Art. en proceso de expansión y de revitali- 16 PAPYRUS SUMMER–FALL 2010
  • 19.
    Street, south ofMarket Street. For some de photographie dans le monde des zación, en el cual tomarĆ­a un papel members of San Francisco society, this musĆ©es, en reconnaissant la photo- importante el museo. Cuando el edifi- was heresy: one just didn’t go ā€œsouth graphie comme une forme d’art bien cio actual se inauguró en enero 1995, of the slotā€ (ā€œslotā€ referring to the avant que ses contemporains. recibió la aclamación de los crĆ­ticos, y cable car slot in the street). The move Dans les annĆ©es 1980, le MusĆ©e avait hasta la fecha nunca ha frenado en was visionary, however, as the ā€œSouth dĆ©passĆ© ses limites d’origine, et on a su afĆ”n de mantener un programa of Marketā€ area was undergoing an commencĆ© Ć  planifier une nouvelle atrevido de exhibiciones y un alto expansion and revitalization, in which installation construite Ć  cet effet. nivel de excelencia en conservación. the Museum was to play a pivotal role. L’architecte Mario Botta a Ć©tĆ© choisi The Museum opened in its current pour concevoir le bĆ¢timent signature Exploratorium building in January 1995 to rave reviews, sur la rue 3e, au sud de la rue du El Exploratorium es un museo experi- and has never slowed down in provid- MarchĆ©. Pour certains membres de la mental diseƱado para fomentar la ing both a bold exhibition program and sociĆ©tĆ© de San Francisco, ce fut une curiosidad a travĆ©s de la interacción a high standard of curatorial excellence. hĆ©rĆ©sie: on ne va pas tout simplement fĆ­sica del visitante con las exhibiciones aller Ā« au sud de la fente Ā» (se rĆ©fĆ©rant —sin importar la edad del visitante o Exploratorium Ć  la fente tĆ©lĆ©phĆ©rique dans la rue). su conocimiento de la ciencia. Atrae a The Exploratorium is an experimental, Le dĆ©mĆ©nagement a Ć©tĆ© visionnaire, los mayores, los jóvenes, los artistas, hands-on museum designed to spark toutefois, et la zone au sud de la rue los cientĆ­ficos, los individuos que han curiosity—regardless of a visitor’s age du MarchĆ© a Ć©tĆ© l’objet d’une expan- sido premiados con el premio Nobel, or familiarity with science. It attracts sion et d’une revitalisation, dans lequel las familias, y a todos los demĆ”s. Este the old, the young, artists, scientists, le MusĆ©e a jouĆ© un rĆ“le central. Le museo que parece combinar elementos Nobel laureates, families, and every- MusĆ©e a ouvert dans son bĆ¢timent de una galerĆ­a de mĆ”quinas de traga- one in between. Like a mad scientist’s actuel en janvier 1995 avec des cri- perras de un cientĆ­fico loco, una casa penny arcade, a scientific funhouse, tiques Ć©logieuses, et n’a jamais ralenti de espejos de Ć­ndole cientĆ­fica, un estu- an art studio and an experimental l’offre d’un programme d’expositions dio de arte y un laboratorio experi- laboratory all rolled into one, you can audacieux et, Ć  la fois, d’un haut niveau mental ofrece la oportunidad de tocar, touch, play, and tinker with hundreds d’excellence de conservation. jugar y manipular centenares de exhi- and hundreds of exhibits. In short, biciones. En breve, es una institución it’s a public educational institution L’Exploratorium educacional pĆŗblica para visitantes de for visitors of all ages. L’Exploratorium c’est un projet expĆ©- todas las edades. This innovative museum of science, rimental, un musĆ©e aux-mains conƧu Este museo innovador de ciencias, technology, art and human percep- pour Ć©veiller la curiositĆ©, indĆ©pen- tecnologĆ­a, arte, y la percepción tion provides the general public— damment de l’âge du visiteur et de sa humana provee al pĆŗblico en general familiaritĆ© avec la science. Elle attire —aun con un conocimiento limitado AMY SNYDER Ā© EXPLORATORIUM – EXPLORATORIUM.EDU les vieux, les jeunes, artistes, scienti- de ciencias—de una experiencia que fiques, laurĆ©ats du prix Nobel, les les ayuda a entender mejor la ciencia y familles et tous les autres. Comme le la naturaleza. Para el 2010, el pĆŗblico savant fou Penny Arcade, le scienti- del Exploratorium se estima en mĆ”s fique drĆ“le, un studio d’art et un labo- de 20 millones para las exhibiciones ratoire expĆ©rimental tout en un, vous en los centros de ciencia y otros lugares pouvez toucher, jouer et bricoler avec alrededor del mundo. MĆ”s de 575,000 des centaines et des centaines d’expo- visitantes vendrĆ”n al Exploratorium sitions. En bref, ceci s’agit d’un Ć©tablis- en San Francisco en 2010 para inter- sement d’enseignement public pour actuar con las exhibiciones originales; les visiteurs de tous ages. 6,000 maestros participarĆ”n en los Ce musĆ©e innovant de la science, programas de desarrollo profesional; la technologie, l’art et la perception 110,000 estudiantes y maestros harĆ”n de l’homme prĆ©voit le grand public, excursiones escolares y 5,000 estudi- mĆŖme ceux qui ont trĆØs peu de con- antes mĆ”s, muchos que provienen naissances scientifiques, avec une expĆ©- de los vecindarios de bajos recursos, rience qui les aide Ć  mieux comprendre recibirĆ”n beneficios por medio del la science et la nature. Pour 2010, les Programa de difusión pĆŗblica para la visiteurs Ć  l’Exploratorium sont estimĆ©s Educación de Jóvenes. Todos los aƱos Ć  plus de 20 million pour les exposi- se venden 5,000 ejemplares de las publi- tions dans les centres de sciences et caciones del Exploratorium, y su sitio d’autres endroits dans le monde entier. de Internet recibe 24 millones de visitas Inside the Exploratorium. Plus de 575 000 visiteurs viendront Ć  durante el aƱo. En el 4to Congreso PAPYRUS SUMMER–FALL 2010 17
  • 20.
    even those withvery limited scientific l’Exploratorium lui-mĆŖme en 2010 Mundial de Centros de Ciencias en knowledge—with an experience that pour interagir avec les originaux expo- RĆ­o de Janeiro en 2005, los centros de helps them to better understand science sitions les mains sur les piĆØces; 6 000 ciencias de cinco continentes le con- and nature. For 2010, the Explorato- enseignants feront partie des pro- cedieron al Exploratorium el primer rium’s audience is estimated at more grammes de perfectionnement profes- puesto. than 20 million for exhibits at science sionnel; 110 000 Ć©tudiants et professeurs centers and other locations worldwide. se rendront sur des sorties scolaires et Las Bibliotecas de la More than 575,000 visitors will come un autre groupe de 5 000 Ć©tudiants Universidad de Stanford to the Exploratorium itself in 2010 to d’un grand nombre de quartiers insuf- Fue fundada en 1885 por Jane y Leland interact with the original, hands-on fisamment desservis de San Francisco Stanford, en honor de su Ćŗnico hijo. exhibits; 6,000 teachers will participate va se bĆ©nĆ©ficier du Programme d’exten- La Universidad de Leland Stanford in professional development programs; sion educative pour l’enfance. Chaque Junior abrió en 1891. El primer presi- 110,000 students and teachers will visit annĆ©e, 50 000 exemplaires de publica- dente de Stanford, David Starr Jordan, on school field trips; and another 5,000 tions de l’Exploratorium sont vendus escribió que ā€œuna gran biblioteca es students, many from San Francisco’s et son laurĆ©at site Web reƧoit 24 mil- el elemento mĆ”s importante en la for- underserved neighborhoods, will bene- lion de visites durant l’annĆ©e. Lors du mación de una gran universidad.ā€ Las fit from the Children’s Educational 4e CongrĆØs mondial des centres scien- colecciones de la biblioteca crecieron Outreach Program. Each year, 50,000 tifiques Ć  Rio de Janeiro en 2005, les lentamente pero sin parar durante copies of Exploratorium publications reprĆ©sentants venus des cinq continents el próximo cuarto de siglo, mientras are sold, and its award-winning website ont classĆ© l’Exploratorium comme la biblioteca padecĆ­a de dificultades receives 24 million visits during the le numĆ©ro un parmi les centres de financieras despuĆ©s del terremoto year. At the 4th Science Center World sciences du monde. devastador de 1906. Un edificio central Congress in Rio de Janeiro in 2005, sci- para la biblioteca que fue construido ence centers from five continents ranked BibliothĆØques de l’UniversitĆ© especĆ­ficamente para ese propósito y the Exploratorium as the number one de Stanford que ahora se conoce como el Ala Bing science center in the world. FondĆ©e en 1885 par Jane et Leland de la Biblioteca Green abrió en 1919. Stanford, en souvenir de leur enfant Hoy, hay 20 bibliotecas en el campus: Stanford University Libraries unique, l’UniversitĆ© Leland Stanford cinco bibliotecas independientes (Leyes, Founded in 1885 by Jane and Leland Junior a ouvert ses portes en 1891. Le Administración de Empresas, Medi- Stanford as a memorial to their only premier prĆ©sident de Stanford, David cina, el Centro de Aceleración Lineal child, Leland Stanford Junior Univer- Starr Jordan, a Ć©crit que Ā« une grande Stanford, y el Instituto Hoover) que sity opened in 1891. Stanford’s first bibliothĆØque est l’élĆ©ment le plus reportan a su decano o director; mien- president, David Starr Jordan, wrote important dans la formation d’une tras que las demĆ”s bibliotecas estĆ”n that, ā€œa great library is the most impor- grande universitĆ© Ā». Les collections de consolidadas como las Bibliotecas de tant element in the formation of a great la BibliothĆØque ont augmentĆ© lente- la Universidad de Stanford y Recursos University.ā€ The Library’s collections ment mais rĆ©guliĆØrement au cours de Información AcadĆ©mica (SULAIR) grew slowly but steadily over the next du prochain quart de siĆØcle, puisque y reportan a la bibliotecaria de la quarter century, as the University strug- l’UniversitĆ© luttait avec des difficultĆ©s universidad. gled with financial difficulties in the aftermath of the devastating 1906 earth- El Centro de Arte Cantor quake. A purpose-built main library Las colecciones diversas del Centro building, now known as the Bing Wing de Arte Cantor abarcan continentes, of Green Library, opened in 1919. Today, there are 20 libraries on campus: RICHARD BARNES five coordinate libraries (Law, Business, Medicine, the Stanford Linear Acceler- ator Center, and the Hoover Institution) report to their dean or director, while the remaining libraries are organized centrally as the Stanford University Libraries and Academic Information Resources, or SULAIR, reporting to the University Librarian. Cantor Arts Center The Cantor Arts Center’s diverse col- lections span continents, cultures, and The Green Library at Stanford University. The Cantor Arts Center. 18 PAPYRUS SUMMER–FALL 2010
  • 21.
    4,000 years ofart history, and include financiĆØres aprĆØs le tremblement de culturas, y 4,000 aƱos de historia de the largest gathering of Rodin bronzes terre devastateur de 1906. Le bĆ¢timent arte e incluyen el grupo mĆ”s grande outside Paris. The Center’s distinguished de la bibliothĆØque construit Ć  cet effet, de esculturas de bronce de Rodin outdoor art collection includes impor- maintenant connu comme l’aille Bing fuera de ParĆ­s. tant figurative and abstract works in a de la BibliothĆØque Green, est ouvert variety of media by artists of the late en 1919. Aujourd’hui, il existe 20 bib- Museo ContemporĆ”neo JudĆ­o nineteenth century to the present. liothĆØques sur le campus: cinq biblio- Con la apertura de su nuevo edificio en thĆØques coordonnĆ©es (droit, commerce, junio 2008, el Museo ContemporĆ”neo Contemporary Jewish Museum mĆ©decine, le Centre Stanford d’accel- JudĆ­o comenzó un nuevo capĆ­tulo With the opening of its new building in eration linĆ©aire, et l’Institution Hoover) despuĆ©s de mĆ”s de 20 aƱos de invo- June 2008, the Contemporary Jewish se rapportent Ć  leur doyen ou direc- lucrar al pĆŗblico y a los artistas en una Museum ushered in a new chapter in teur, alors que le reste des bibliothĆØques exploración de perspectivas contem- more than 20 years of engaging audi- sont encore organisĆ©es de maniĆØre porĆ”neas de la cultura, la historia, ences and artists in exploring contem- centralisĆ©e, comme les bibliothĆØques el arte, y las ideas judĆ­as. La nueva porary perspectives on Jewish culture, de l’UniversitĆ© de Stanford et les Res- instalación premiada, diseƱada por el history, art, and ideas. The new award- sources d’information acadĆ©mique ou arquitecto de fama mundial, Daniel winning facility, designed by interna- SULAIR, dĆ©pendant du bibliothĆ©caire Libeskind, es un centro dinĆ”mico tionally renowned architect Daniel de l’UniversitĆ©. donde todos pueden reunirse para Libeskind, is a lively center where people experimentar el arte, compartir per- of all ages and backgrounds can gather Centre des arts Cantor spectivas diversas, y participar de lleno to experience art, share diverse per- Les diverses collections du Centre des en exhibiciones prĆ”cticas sin importar spectives, and engage in hands-on activ- arts Cantor couvrent des continents, la edad ni el origen de los visitantes. ities. Inspired by the Hebrew phrase des cultures, et 4 000 ans d’histoire Inspirado en la frase hebrea ā€œL’Chaimā€ ā€œL’Chaimā€ (To Life), the building is a de l’art, et notamment le plus grand (A la Vida), el edificio es una mani- physical embodiment of the Contem- rassemblement des bronzes de Rodin festación fĆ­sica de la misión del Museo porary Jewish Museum’s mission to en dehors de Paris. ContemporĆ”neo JudĆ­o de unir la tra- bring together tradition and innova- dición y la innovación en la exploración tion in an exploration of the Jewish Le Museum juif contemporain de la experiencia judĆ­a en el siglo veinte experience in the twenty-first century. Avec l’ouverture de son nouveau bĆ¢ti- y uno. ment en Juin 2008, le MusĆ©e juif con- de Young Museum temporain a inaugurĆ© un nouveau Museo de Young The de Young Museum, housed in a chapitre de plus de 20 ans d’engage- El Museo de Young, ubicado en un landmark building designed by Herzog ment avec le public et les artistes explo- edificio de reconocida importancia & de Meuron and located in Golden rant les perspectives contemporaines diseƱado por Herzog & de Meuron y Gate Park, is the fourth most-visited sur la culture juive, l’histoire, l’art et les situado en el Parque Golden Gate, es idĆ©es. Le nouvel Ć©tablissement laurĆ©at, el museo de arte nĆŗmero cuatro en conƧu par l’architecte internationale- cantidad de visitantes en los EEUU, y BRUCE DAMONTE/COURTESY OF THE CONTEMPORARY JEWISH MUSEUM ment renommĆ© Daniel Libeskind, est tiene el puesto dĆ©cimo sexto en visitas un centre animĆ© où des personnes a los museos a nivel mundial. Sus de tous Ć¢ges et origines peuvent s’y exhibiciones contienen arte americano retrouver pour vivre l’art, Ć  partir de desde el siglo diez y siete hasta el siglo leurs perspectives diffĆ©rentes, et de veintiuno; arte textil y vestimenta inter- s’engager dans des activitĆ©s pratiques. nacional; arte de Ɓfrica, de las AmĆ©ricas, InspirĆ© par l’expression hĆ©braĆÆque la región de Asia y del PacifĆ­co. Ā« L’Chaim Ā» (Ć  la vie), le bĆ¢timent est un mode de rĆ©alisation physique de la mission du MusĆ©e juif contemporain de rĆ©unir la tradition et l’innovation dans une exploration de l’expĆ©rience juive dans le XXIe siĆØcle. Le MusĆ©e de Young Le musĆ©e de Young, abritĆ© dans un bĆ¢timent conƧu par Herzog & de Meuron et situĆ© dans le Parc Golden Gate, est le quatriĆØme musĆ©e d’art le The Contemporary Jewish Museum plus visitĆ© aux Ɖtats-Unis, et le 16e musĆ©e The de Young Museum. PAPYRUS SUMMER–FALL 2010 19
  • 22.
    art museum inthe United States, and d’art le plus visitĆ© du monde. Il met en La Academia de Ciencias the 16th most-visited art museum in the valeur l’art amĆ©ricain du dix-septiĆØme de California world. It showcases American art from au vingt et uniĆØme siĆØcles, les arts tex- Hogar del Acuario Steinhart, el Museo the seventeenth through the twenty- tiles et des costumes internationaux de Historia Natural Kimball, el Plane- first centuries, international textile et l’art des AmĆ©riques, de la rĆ©gion tarium Morrison, y programas de arts and costumes, and art from the du Pacifique et de l’Afrique. investigación y educación de calidad Americas, the Pacific Rim, and Africa. mundial, la Academia de Ciencias de L’AcadĆ©mie des sciences California es uno de los destinos. Desde California Academy of Sciences de la Californie los pingüinos chapoteando hasta las Home to the Steinhart Aquarium, the Accueil de l’Aquarium Steinhart, le flores silvestres en el techo, el edifico Kimball Natural History Museum, the MusĆ©e d’histoire naturelle Kimball, estĆ” rebosante de vida. Morrison Planetarium, and world-class le planĆ©tarium Morrison, et des pro- Un bosque tropical de cuatro pisos research and educational programs, grammes mondiaux de recherche et y un magnifico sistema ecológico the California Academy of Sciences is Ć©ducatifs, l’AcadĆ©mie des sciences de de coral deleitarĆ”n a los visitantes one of San Francisco’s must-see desti- la Californie est l’une des destinations de todas las edades, mientras que el nations. From the splashing penguins Ć  voir Ć  San Francisco. Des Ć©clabouss- programa del espacio sumerge a su in African Hall to the wildflowers on ures des penguins Ć  la salle de l’Afrique pĆŗblico en una experiencia que trans- the roof, the building is bursting with jusqu’aux fleurs sauvages sur le toit, le porta a los participantes mĆ”s allĆ” de las life. A four-story living rainforest and bĆ¢timent est plein de vie. Une forĆŖt de fronteras de nuestra planeta. Abundan awe-inspiring coral reef ecosystem will vie de quatre Ć©tages et un impression- las oportunidades para conocer a los delight visitors of all ages, while immer- nant Ć©cosystĆØme de rĆ©cifs coralliens cientĆ­ficos de la Academia, compartir sive Space shows transport audiences raviront les visiteurs de tous Ć¢ges, tandis sus descubrimientos y sumarse al beyond the boundaries of our planet. que le spectacle de l’espace immersif movimiento para convertir a nuestro Opportunities abound to meet Academy transport le public au-delĆ  des limites de mundo en un lugar donde vivamos en scientists, share in their discoveries, and notre planĆØte. Les dĆ©bouchĆ©s abondent armonĆ­a ecológica de una manera join the journey to make our world pour se rencontrer avec des scienti- sostenible. a greener, more sustainable place in fiques de l’AcadĆ©mie, partager leurs which to live. dĆ©couvertes, et rejoindre la route pour Museo de la Familia rendre notre monde plus vert, un lieu de Walt Disney Walt Disney Family Museum plus durable pour vivre. Walt Disney fue uno de los personajes Walt Disney was one of the most influ- mĆ”s influyentes del siglo veinte y su ential figures of the twentieth century, Le MusĆ©e de la famille popularidad mundial sigue hasta la and his worldwide popularity lives on de Walt Disney fecha. Con la ayuda de pelĆ­culas de to this day. Through animated and Walt Disney a Ć©tĆ© l’une des personna- dibujos animados y de acción en vivo, live-action films, television shows and litĆ©s les plus influentes du XXe siĆØcle, programas de televisión y parques theme parks, Disney created global et sa popularitĆ© vit dans le monde entier temĆ”ticos, Disney creó sĆ­mbolos glo- symbols, stories and characters that are Ć  ce jour. GrĆ¢ce aux films animĆ©s et les bales, historias y personajes que son an indelible part of our popular cul- films d’action, des Ć©missions de tĆ©lĆ©vi- una parte indeleble de nuestra cultura ture. The Walt Disney Family Museum sion et des parcs thĆ©matiques, Disney a popular. El museo de la Familia de Walt was conceived to present the real story crƩƩ des symboles globaux, des histoires Disney fue concebido para presentar The California Academy of Sciences. The Walt Disney Family Museum. 20 PAPYRUS SUMMER–FALL 2010
  • 23.
    of Walt Disneythe man, as told by him et des personnages qui font partie indĆ©- la verdadera historia de Walt Disney, el and by others who knew him well. The lĆ©bile de notre culture populaire. Le hombre, contado por Ć©l y por quienes Museum is located in the Presidio of MusĆ©e de la famille de Walt Disney a lo conocĆ­an bien. El museo se ubica San Francisco: a former U.S. Army base Ć©tĆ© conƧu pour prĆ©senter la vĆ©ritable en el Presidio de San Francisco; una that is now a National Park. The three histoire de Walt Disney l’homme, telle base de la armada de EEUU que ahora buildings that house the Museum are on que racontĆ©e par lui et par d’autres qui es un parque nacional. Los tres edi- the National Register of Historic Places. le connaissaient bien. Le MusĆ©e est situĆ© ficios que contienen el museo estĆ”n en dans le Presidio de San Francisco: une la lista nacional de lugares históricos San Francisco Maritime Museum ancienne base de l’armĆ©e amĆ©ricaine de EEUU. The San Francisco Maritime Museum qui est maintenant un parc national. is located in the Aquatic Park Historic Les trois bĆ¢timents qui abritent le El Museo MarĆ­timo District: a National Historic Landmark musĆ©e sont sur le Registre national de San Francisco located on San Francisco Bay. The des lieux historiques. Ubicado en el distrito histórico del Park’s distinctive Streamline Modern Parque AcuĆ”tico en la bahĆ­a de style WPA building stands at the foot Le MusĆ©e maritime San Francisco, el Museo MarĆ­timo of Polk Street. It was originally built de San Francisco de San Francisco aparece en la lista as a public bathhouse in 1936, and Le MusĆ©e maritime de San Francisco nacional de edificios históricos. El now houses the Maritime Museum. Its est situĆ© dans le district historique du edificio WPA del distintivo estilo interior is decorated with fantastic and Parc aquatique: un point historique aerodinĆ”mico se encuentra al pie colorful murals. Although the Museum de rĆ©pĆØre national situĆ© sur la baie de de la calle Polk. Originalmente se is currently under renovation, IAMFA San Francisco. Le distinctif bĆ¢timent construyó como una sauna pĆŗblica en is fortunate to be able to host the Gala du Parc (un des Ā« WPA buildings Ā») Ć  1936, y ahora es el hogar del Museo dinner of its 20th annual conference style Ā« paquebot Ā», se trouve au pied de MarĆ­timo. Las paredes en su interior on the Museum’s third floor, before la rue Polk. Il a Ć©tĆ© construit comme estĆ”n decoradas con pinturas murales it is returned to its main function as un bain public en 1936, et aujourd’hui fantĆ”sticas y coloridas. Aunque ahora a visiting exhibitions gallery. abrite le MusĆ©e maritime. Son intĆ©rieur se halla en renovación, IAMFA podrĆ” est dĆ©corĆ© de peintures murales fan- celebrar el banquete y la cena de gala Runnymede Sculpture Farm tastiques et colorĆ©s. Bien que le musĆ©e de la vigĆ©sima conferencia anual en el Members and guests will visit Runny- est actuellement en rĆ©novation, l’IAMFA tercer piso del museo, antes de que mede Sculpture Farm for a tour and a la chance d’être en mesure d’accueillir vuelva a su función normal de galerĆ­a California BBQ. le dĆ®ner de gala de son 20e ConfĆ©rence para las exhibiciones prestadas de annuelle sur le troisiĆØme Ć©tage du otros museos. Golden Gate Bridge MusĆ©e, avant qu’il ne soit retournĆ© Ć  sa principale fonction de galerie La Finca con esculturas The Golden Gate Bridge was the long- d’exposition visitante. Runnymede est suspension bridge in the world when it was completed in 1937, and has be- Los miembros e invitados visitarĆ”n a come one of the most internationally La Grange aux sculptures la finca con esculturas Runnymede recognized symbols of San Francisco, Runnymede para un paseo y una barbacoa de tipo California, and the United States. Since Les membres et leurs invitĆ©s se rendront California. its completion, the span’s length has Ć  la Grange aux sculptures Runnymede been surpassed by eight other bridges. pour une visite et y profiter d’un El Puente Golden Gate It still has the second-longest suspen- barbecue Ć  la Californie. El Puente Golden Gate era el puente sion bridge main span in the United suspendido mĆ”s largo del mundo JOE MAY States. It is estimated that about nine million people from around the world JOE MAY visit the Bridge each year. The San Francisco Maritime Museum. Runnymede Sculpture Farm. The Golden Gate Bridge. PAPYRUS SUMMER–FALL 2010 21
  • 24.
    Letterman Digital ArtsCenter Le Pont Golden Gate cuando se terminó en 1937 y se ha The Letterman Digital Arts Center seam- Le Pont Golden Gate Ć©tait le plus long convertido en uno de los sĆ­mbolos lessly integrates motion picture, visual pont suspendu du monde quand il a mĆ”s reconocidos de San Francisco, effects and gaming technologies on one Ć©tĆ© achevĆ© en 1937, et il est devenu California y de los EEUU. Luego de su world-class digital arts campus. The 23- l’un des symboles les plus reconnus terminación, ocho puentes alrededor acre campus is the new San Francisco internationalement de San Francisco, del mundo le han superado en largo, home of Lucasfilm Ltd., bringing en Californie et aux Ɖtats-Unis. Depuis pero solo uno dentro de los EEUU together Industrial Light & Magic, son achĆØvement, la longueur de la en cuanto a su tramo en suspensión. LucasArts and Lucasfilm’s corporate travĆ©e a Ć©tĆ© dĆ©passĆ©e par huit autres Se estima que mĆ”s de 9 millones de activities for the first time in the ponts du monde. Mais aux Etats-Unis, il visitantes acuden al puente desde company’s nearly 40-year history. dĆ©tient la deuxiĆØme place par la taille diferentes puntos del mundo cada aƱo. de la portĆ©e suspendue. On estime que Sir Francis Drake Hotel prĆØs de neuf millions de personnes El Centro de Artes Digitales Few hotels in the country are as synony- de partout le monde entier visitent le Letterman mous with the city they call home as pont chaque annĆ©e. El Centro de Artes Digitales Letterman the Sir Francis Drake Hotel. Known by integra sin dificultad las tecnologĆ­as locals as ā€œThe Drakeā€, the hotel defines Le Centre des arts digitaux de pelĆ­culas, de efectos visuales espe- San Francisco: exciting, romantic, and Letterman ciales, y de juegos de video en un solo a little offbeat. Take in the ornate lobby Le Centre d’arts digitaux Letterman campus de artes digitales de calidad and the romantic clang of the cable intĆØgre de faƧon transparente le cinĆ©ma, mundial. El campus de 23 acres es el cars—it’s all part of the legendary les effets visuels et les technologies nuevo hogar de Lucasfilm Ltd., el cual San Francisco experience. When this de jeu sur un campus de classe mon- consolida las actividades corporativas historic hotel opened its doors in 1928, diale des arts numĆ©riques. Le campus de Industrial Light & Magic, LucasArts the city had never seen anything like de 23 acres est la nouvelle maison y Lucasfilm por primera vez desde que it. Although the city boasted a number Ć  San Francisco de Lucasfilm Ltd, se fundó la compaƱƭa hace 40 aƱos. of luxury hotels, the Sir Francis Drake rĆ©unissant Industrial Light & Magic, Hotel was something else entirely: a LucasArts et les activitĆ©s de la sociĆ©tĆ© El Hotel Sir Francis Drake sleek state-of-the-art marvel reflecting Lucasfilm pour la premiĆØre fois dans Pocos hoteles en el paĆ­s tienen una the dynamic spirit of a new metropolis une entreprise de prĆØs de 40 ans imagen tan representativa de la ciudad emerging from the devastating 1906 d’histoire. en que se ubican como el Hotel Sir earthquake. Francis Drake. Conocido por los resi- The Starlight Room is located on L’HĆ“tel Sir Francis Drake dentes locales como ā€œThe Drakeā€, el the 21st floor of the Sir Francis Drake Peu d’hĆ“tels dans le pays peuvent ĆŖtre hotel define a San Francisco; emocio- Hotel in San Francisco, location of the considĆ©rĆ©s le synonyme de la ville nante, romĆ”ntico y un poco excĆ©ntrico. opening ceremonies for the twentieth qu’ils appellent maison comme le fait Observen el vestĆ­bulo ornamentada y annual IAMFA conference. l’HĆ“tel Sir Francis Drake. Connu par los estruendos de los tranvĆ­as—todo es parte de la experiencia legendaria State Railroad Museum de San Francisco. Cuando este hotel Located in Old Sacramento, the abrió sus puertas en 1928, la ciudad California State Railroad Museum is nunca habĆ­a visto nada parecido. a complex of historical facilities and Aunque la ciudad ofrece varios hoteles unique attractions. Widely regarded as de lujo, el Hotel Sir Francis Drake North America’s most popular railroad es algo completamente diferente: un museum, there is something here for hotel elegante con toda la tecnologĆ­a everyone, including lavishly restored mĆ”s corriente que refleja el espĆ­ritu dinĆ”mico de una nueva metrópolis que emergió del terremoto devastador de 1906. The Letterman Digital Arts Center. The Sir Francis Drake Hotel. The Starlight Room. 22 PAPYRUS SUMMER–FALL 2010
  • 25.
    trains, engaging exhibits,and unique les habitants comme Ā« Le Drake Ā», El Salon ā€œStarlightā€ se ubica en special events. l’hĆ“tel dĆ©finit San Francisco: passion- el vigĆ©simo primer piso del Hotel nante, romantique, et un peu dĆ©calĆ©. Sir Francis Drake, el lugar de la cere- Crocker Art Museum Profiter du superbe salon et des roman- monia de apertura de la vigĆ©sima The Crocker Art Museum in Sacramento tiques tintements des sons mĆ©talliques conferencia anual de IAMFA. has embarked on the most monumen- des cĆ¢ble-voitures qui font tous partie de tal endeavor in its 125-year history. An l’expĆ©rience lĆ©gendaire de San Fran- El Museo Estatal del Ferrocarril expansion project is underway, not only cisco. Lorsque cet hĆ“tel historique a Ubicado en Viejo Sacramento, el tripling the size of the current facility ouvert ses portes en 1928, la ville n’avait Museo Estatal del Ferrocarril es un but spanning all facets of the organiza- jamais rien vu de pareil. Bien que la ville complejo de instalaciones históricas y tion, from collection and endowment comptait un certain nombre d’hĆ“tels atracciones Ćŗnicas. Es considerado el growth to enriching every aspect of the de luxe, l’HĆ“tel Sir Francis Drake a museo de ferrocarril de Norte AmĆ©rica visitor experience. The new Crocker Ć©tĆ© tout une autre chose: un Ć©tat mag- mĆ”s popular, hay algo de interĆ©s para Museum is set to open to the public nifique et impeccable de l’art qui reflĆØte todo el mundo, incluyendo trenes res- on October 10, 2010. l’esprit dynamique d’une nouvelle taurados con mucho esmero, exhibi- mĆ©tropole qui sort du dĆ©vastateur ciones interesantes, y eventos especiales State Capitol tremblement de terre de 1906. Ćŗnicos. At the State Capitol in Sacramento, the La salle Starlight est situĆ©e au 21e past, present and future of California Ć©tage de l’HĆ“tel Sir Francis Drake, Ć  El Museo de Arte Crocker interact. The building serves as both San Francisco, le lieu de la cĆ©rĆ©monie El Museo de Arte Crocker en Sacra- a museum and as the state’s working d’ouverture de la vingtiĆØme confĆ©rence mento se ha embarcado en la obra seat of government. Visitors to the annuelle de l’IAMFA. mĆ”s monumental de su historia de Capitol can experience California’s 125 aƱos. Un proyecto de expansión rich history, while also witnessing the Le MusĆ©e du chemin de fer estĆ” en progreso, que no solamente making of history through the modern de l’État triplica el tamaƱo de su instalación lawmaking process. SituĆ© dans le Vieux Sacramento, le actual sino que abarca todas las facetas CONTINUED ON PAGE 26 MusĆ©e du chemin de fer de l’État est un de la organización, desde el crecimi- complexe d’installations historiques ento de sus colecciones y de sus anfi- et des attractions uniques. ConsidĆ©rĆ© triones hasta el enriquecimiento de comme l’un des musĆ©es du chemin de todos los aspectos de la experiencia de fer en AmĆ©rique du Nord les plus los visitantes. El Museo Crocker estĆ” populaires, il y a ici quelque chose programado para abrir al pĆŗblico el pour tout le monde, y compris les 10 de octubre de 2010. trains somptueusement restaurĆ©s, l’engagement des expositions, des El Capitolio del Estado Ć©vĆ©nements spĆ©ciaux et uniques. El pasado, el presente, y el futuro de California se interactĆŗan en el Le MusĆ©e d’art Crocker Capitolio del Estado. El edificio sirve Le MusĆ©e d’art Crocker Ć  Sacramento tanto de museo como de sede oficial del a lancĆ© l’entreprise la plus monumen- gobierno. Los visitantes al Capitolio tale de son histoire de 125 ans. Un pueden experimentar la historia rica de projet d’agrandissement est en cours, California, mientras observan la cre- The State Railroad Museum. non seulement triplant la taille de ación de historia a travĆ©s del moderno l’installation actuelle, mais couvrant proceso de crear leyes. SIGUE EN LA PƁGINA 26 tous les aspects de l’organisation, de la collecte et la croissance de dotation jusqu’à l’enrichissement de tous les aspects de l’expĆ©rience du visiteur. Le nouveau MusĆ©e Crocker est prĆŖt Ć  ouvrir au public le 10 Octobre 2010. Le Capitol de l’État Au Capitole de l’État Ć  Sacramento, le passĆ©, le prĆ©sent et l’avenir de la Californie interagissent. Le bĆ¢timent sert Ć  la fois de musĆ©e et de siĆØge de The Crocker Art Museum. SUITE ƀ LA PAGE 26 The State Capitol. PAPYRUS SUMMER–FALL 2010 23
  • 26.
    2010 IAMFA Con DELEGATE PROGRAM SUNDAY, O 8:00 am Benchmarking Registration and Breakfast Sir Francis Drake (SFD) Hotel, 450 Powell 12:00 pm Conference Registration and Bag Pickup for Sir Francis Drake Hotel, Mezzanine Everyone Lobby 6:00 pm Ice Breaker Reception and Welcome Harry Denton’s Starlight Room, SFD MONDAY, O 8:00 am Travel to Breakfast at SFMOMA San Francisco Museum Of Modern Art The new rooftop Garden at 9:30 am Benchmarking Recap, LED Lighting Presentations, SFMOMA’s Phyllis Wattis Theater SFMOMA. Tour 11:30 am Travel to Lunch at Stanford University To Stanford Bing Wing Library 1:30 pm Tour and Seismic Presentation Stanford Libraries 4:30 pm Tour Cantor Art Center with Guests Cantor Art Center 5:15 pm Travel to Runnymede, Walking Sculpture Tour Runnymede Sculpture Farm and BBQ 8:30 pm Travel to Hotel To Sir Francis Drake Hotel TUESDAY, O The Stanford University campus. 8:00 am Travel to Breakfast at De Young Museum To Golden Gate Park 9:30 am IAMFA Master Planning Session, DeYoung De Young Museum Presentation, Tour 12:30 pm Lunch in the Forum Facing the Shakespeare Garden California Academy of Sciences 2:00 pm Green Historic Preservation, LEED Platinum Bldg., California Academy of Sciences Tours 5:00 pm Return to Hotel for Free Evening To Sir Francis Drake Hotel 6:00 pm Board Meeting Sir Francis Drake Hotel WEDNESDAY, The deYoung Museum, open now for nearly five years. 8:00 am Travel to Breakfast, Annual Business Meeting Contemporary Jewish Museum and Tour 10:45 am Innovation in the Exploratorium’s New Plans Exploratorium and Tour 12:30 pm Lunch at Letterman Digital Arts Center Letterman Digital Arts Center 1:45 pm Historic Preservation Award Winner and Tour Walt Disney Family Museum 3:30 pm Walk across Golden Gate Bridge, W5 From North toward City 4:45 pm Travel to Hotel, Dress for Gala Dinner Sir Francis Drake Hotel 6:00 pm Group Photo and Wine, Gala Dinner Maritime Museum The new LEED Platinum California 10:00 pm Bus back to Hotel Academy of Sciences. THURSDAY, OCTOBER 21 — ā€œA CAPITAL IDEAā€ 8:30 am Day Tour to Sacramento Bus Departs SFD 9:30 am Benicia for Coffee Old State Capitol 10:00 am Travel onward and Facilities Tour State Railroad Museum 12:00 pm Lunch Aboard Delta King 1:30 pm Tour Museum Crocker Art Museum 3:00 pm Travel to Capitol for Tour Architectural Tour The Exploratorium, a hands-on 5:00 pm Drinks and Tour, Depart for Hotel at 6:00 pm Historic Governor’s Mansion experience for all who visit. 24 PAPYRUS SUMMER–FALL 2010
  • 27.
    ference Schedule GUEST PROGRAM CTOBER 17 12:00 pm Conference Registration and Bag Pickup for Sir Francis Drake (SFD) Hotel, Everyone Mezzanine Lobby 6:00 pm Ice Breaker Reception and Welcome Harry Denton Starlight Room, SFD CTOBER 18 8:00 am Travel to Breakfast in the Garden Court Palace Hotel 9:30 am Narrated SF Walking Tour—Ends at SFMOMA Downtown The Garden Court at the famous Palace Hotel. 11:30 am Travel to Lunch at Stanford with Delegates To Stanford Bing Wing Library 1:30 pm Shop, Stroll, Meander Downtown Palo Alto 4:30 pm Join Delegates on Docent tour of Cantor Art Center Cantor Art Center 5:15 pm Travel to Runnymede, Walking Sculpture Tour Runnymede Sculpture Farm and BBQ 8:30 pm Travel to Hotel To Sir Francis Drake Hotel CTOBER 19 8:30 am Head for the Napa Valley Bus Transfer with Snacks on Board One of many sculptures at 10:00 am Champagne and Light Picnic on the Terrace Gloria Ferrer Runnymede Farm. 11:30 am Transfer to Lunch/Wine Pairing and Tour Nicholson Ranch 3:30 pm Transfer to Hess Collection Tour and Tasting The Hess Collection 5:30 pm Return to Hotel To Sir Francis Drake Hotel 7:00 pm Free Evening OCTOBER 20 8:30 am Light Tea Breakfast Near Hotel The Golden Gate Bridge. 9:30 am Walk/Bus Transfer to Chinatown Chinatown 10:00 am Explore Chinatown with Author Shirley Torres Chinatown 1:30 pm Travel to Disney Family Museum for Tour Walt Disney Family Museum 3:30 pm Walk across Golden Gate Bridge, W5 From North toward City 4:45 pm Travel to Hotel, Dress for Gala Dinner Sir Francis Drake Hotel 6:00 pm Group Photo and Wine, Gala Dinner Maritime Museum The vineyards at Gloria Ferrer 10:00 pm Bus back to Hotel winery. — EXTRA DAY TOUR (Additional Cost of $75) See Delegate Schedule for Sacramento Wine-tasting at The Hess Collection winery, located atop Mount Veeder. PAPYRUS SUMMER–FALL 2010 25
  • 28.
    THE TWENTIETH ANNUALIAMFA CONFERENCE LA VINGTIƈME CONFƉRENCE DE L’IAMFA LA VIGƉSIMA CONFERENCIA ANUAL DE IAMFA CONTINUED FROM PAGE 23 SUITE DE LA PAGE 23 VIENE DE LA PƁGINA 23 Historic Governor’s Mansion travail du gouvernement de l’État. Les La Mansión histórica del California’s executive mansion, pop- visiteurs du Capitole peuvent connaĆ®tre Gobernador ularly known as the Governor’s la riche histoire de la Californie, tandis La Mansión Ejecutiva de California, Mansion, was built in 1877 for Albert qu’ils assistent aussi Ć  la rĆ©alisation conocida popularmente como la and Clemenza Gallatin. Albert was a de l’histoire Ć  travers du moderne Mansión del Gobernador, fue con- partner in the Sacramento hardware processus lĆ©gislatif. struida en 1877 por Albert y Clemenza store of Huntington & Hopkins. The Gallatin. Albert era socio en la ferre- State of California purchased the house La Masion historique du terĆ­a de Huntington & Hopkins, en from Joseph and Louisa Steffens to Gouverneur Sacramento. El estado de California use as a home for California’s first La Maison executive de la Californie, compró esta casa a Joseph y Louisa families in 1903 for $32,500. populairement connu comme la Maison Steffens para usarla como un hogar du Gouverneur, a Ć©tĆ© construite en para las primeras familias de 1877 pour Albert et Clemenza Gallatin. California en 1903 por $32,500. Albert Ć©tait partenaire de la quin- Guests of IAMFA members attending caillerie Huntington & Hopkins, Ć  the conference this year will have their Sacramento. L’État de la Californie own agenda as usual, offering an expe- acheta la maison Ć  Joseph et Louisa Los invitados de los miembros de rience of San Francisco that they won’t Steffens pour l’utiliser comme un IAMFA que asisten a la conferencia soon forget. Guest activities include: foyer pour les premiĆØres familles de este aƱo tendrĆ”n tambiĆ©n su propio • Breakfast at the Palace Hotel la Californie en 1903, pour 32 500 $. itinerario como de costumbre, que les ofrece una experiencia de San Francisco • Tour of the Walt Disney Family que no se olvidarĆ”n pronto. Las Museum (Delegates and Guests) actividades de los invitados incluirĆ”n: • Walk across Golden Gate Bridge Les invitĆ©s des membres d’IAMFA toward San Francisco (Delegates • un desayuno en el Hotel Palace assistant Ć  la confĆ©rence de cette and Guests) una gira al Museo de la Familia de annĆ©e auront leur propre ordre du Walt Disney (delegados e invitados) • Annual Gala Banquet at the jour comme d’habitude, offrant une Maritime Museum (Delegates expĆ©rience de San Francisco qu’ils • un paseo por el Puente Golden Gate and Guests) n’oublieront pas de sitĆ“t. Ces activitĆ©s hacia San Francisco (delegados e comprennent: invitados) • Tour of Runnymede Sculpture Farm plus California BBQ (Delegates and • Petit dĆ©jeuner Ć  l’HĆ“tel Palace • cena y fiesta de gala en el Museo Guests) MarĆ­timo (delegados e invitados) • Visite guidĆ©e du MusĆ©e de famille • Champagne and Light Picnic on de Disney Walt (dĆ©lĆ©guĆ©s et invitĆ©s) • una gira a la Finca con esculturas the Terrace of Gloria Ferrer Winery Runnymede y una barbacoa estilo • Traverser le Pont Golden Gate vers California (delegados e invitados) in Napa Valley San Francisco (dĆ©lĆ©guĆ©s et invitĆ©s) • Interactive Lunch and Wine • champaƱa y una merienda liviana Pairing and Tour at Nicholson • Le banquet de gala annuel au MusĆ©e en la terraza del viƱedo de Gloria Ranch in Napa Valley maritime (dĆ©lĆ©guĆ©s et invitĆ©s) Ferrer en el valle de Napa • Hess Collection Tour and Tasting • Tour de la Grange aux sculptures • una merienda interactiva y guĆ­a de in Napa Valley Runnymede plus le barbecue Ć  la combinar vinos con una gira en el Californie (dĆ©lĆ©guĆ©s et invitĆ©s) rancho Nicholson del valle de Napa • Pique-nique Champagne et LumiĆØre • una gira de la colección Hess y sur la terrasse de la cave Gloria degustación en el valle de Napa Ferrer dans la vallĆ©e de Napa Tour • explorar el Barrio Chino con • Tour de la Collection Hess et Shirley Fong-Torres, autor de The dĆ©gustation dans la vallĆ©e de Napa Woman who Ate Chinatown (La Mujer • Explorer Chinatown (quartier que comió al Barrio Chino) chinois) avec Shirley Fong-Torres, • paseo a pie narrado de San Francisco auteur de La femme qui mangea Chinatown (The Woman who Ate • almuerzo en la Universidad de The Governor’s Mansion. Chinatown) Stanford (delegados e invitados) 26 PAPYRUS SUMMER–FALL 2010
  • 29.
    • Explore Chinatownwith Shirley • Visite Ć  pied et commentĆ©e de • salida de compras en el centro de Fong-Torres, author of The Woman San Francisco Palo Alto who Ate Chinatown • DĆ©jeuner Ć  l’UniversitĆ© de Stanford • gira con docentes del Centro • Narrated San Francisco Walking (dĆ©lĆ©guĆ©s et invitĆ©s) de Artes Cantor (delegados y Tour invitados) • Les Grands magasins au centre-ville • Lunch at Stanford University de Palo Alto • visita a las instalaciones del Museo (Delegates and Guests) del Ferrocarril Estatal (jueves— • Tour d’enseignants au Centre delegados e invitados) • Shopping Spree in Downtown d’arts Cantor (dĆ©lĆ©guĆ©s et invitĆ©s) Palo Alto • gira del Museo de Arte Crocker • Visite des installations du MusĆ©e (jueves—delegados e invitados) • Docent tour of Cantor Arts Center du chemin de fer de l’Etat (jeudi – (Delegates and Guests) dĆ©lĆ©guĆ©s et invitĆ©s) • gira al Capitolio del Estado con Ć©nfasis en la arquitectura (jueves— • Visit State Railroad Museum for • Tour au MusĆ©e d’art Crocker (jeudi – delegados e invitados) Facilities Tour (Thursday—Delegates dĆ©lĆ©guĆ©s et invitĆ©s) and Guests) • visita a la histórica Mansión del • Visite architecturale du Capitol Gobernador (jueves—delegados e • Crocker Art Museum Tour (jeudi – dĆ©lĆ©guĆ©s et invitĆ©s) invitados) (Thursday—Delegates and Guests) • Tour Ć  la Maison historique du • State Capitol Architectural Tour Gouverneur (jeudi – dĆ©lĆ©guĆ©s et Deseamos darle la bienvenida a (Thursday—Delegates and Guests) invitĆ©s) todos los miembros de IAMFA y sus invitados a San Francisco. Por favor • Historic Governor’s Mansion Tour Nous sommes impatients d’accueillir consulten www.IAMFA.org, y regĆ­strense (Thursday—Delegates and Guests) tous les membres de l’IAMFAet leurs antes del 17 de agosto para conseguir invitĆ©s Ć  San Francisco. S’il vous plaĆ®t el descuento de registro temprano. We are eager to welcome all IAMFA voir www.IAMFA.org et inscrivez-vous Por favor llamen a 800-795-7129 y members and their guests to San Fran- avant le 17 aoĆ»t pour obtenir le rabais mencionen a la conferencia anual de cisco. Please see www.IAMFA.org, and pour toute inscription. S’il vous plaĆ®t IAMFA para reservar su cuarto en el register before August 17 to get the appelez Ć©galement 800-795-7129 et Hotel Sir Francis Drake. Hay un precio early registration discount. Please also mentionnez la ConfĆ©rence annuelle de negociado por cuarto de $169 por call 800-795-7129 and mention the l’IAMFA pour rĆ©server votre chambre noche para un cuarto ā€œKing Deluxeā€, IAMFA annual conference to reserve Ć  l’HĆ“tel Sir Francis Drake. Il y a un pero por favor no esperen hasta el your room at the Sir Francis Drake frais nĆ©gociĆ© de 169 $ par nuit pour Ćŗltimo momento para reservar su Hotel. There is a negotiated room rate une chambre King Deluxe, mais nous cuarto, para evitar que excedamos of $169 per night for a King Deluxe vous prions de ne pas attendre la nuestro bloque de cuartos. room, but please do not wait until the derniĆØre minute pour rĆ©server votre last minute to reserve your room; we chambre; nous pourrions dĆ©passer le Ā”Nos vemos en San Francisco! could exceed the room block. bloc de chambres. El Equipo de la Conferencia See You in San Francisco! Voyez-nous Ć  San Francisco! The Conference Team L’équipe de la ConfĆ©rence Become a Member of IAMFA For more information on becoming a member of the International Association of Museum Facility Administrators, please visit WWW.IAMFA.ORG or See page 34 for details and enrollment form PAPYRUS SUMMER–FALL 2010 27
  • 30.
    The National Gallery CastingNew Light on Old Masters By Steve Vandyke L ondon’s National Gallery is now better equipped to present its Old Masters in the best possible light— quite literally. Through the employ- ment of Andrew Reid & Partners and its own Trend Building Management System (BMS), the National Gallery’s Technical Services department has developed and begun implementing a new strategy for controlling gallery roof blinds. This new system will allow the collections to be viewed in natural lighting for longer periods, whilst still protecting them from direct sunlight. In addition to enhancing the viewer’s appreciation of a painting, the use of daylight to provide illumination reduces the need for artificial lighting, thus saving energy. The Trend BMS provides close con- trol and monitoring of environmental The National Gallery as seen from Trafalgar Square. conditions throughout the National Gallery’s main building. In doing so, it plays a vital role in preserving the When modulating the motorized The BMS also incorporates an exter- Gallery’s priceless collection of Western blinds to achieve set-points for light nal lux sensor that shows whether it is European paintings from the thirteenth levels, the controllers must ensure sunny or overcast. When it is overcast, through nineteenth centuries, includ- that no direct sunlight is admitted. In the output from the max/min angle ing masterpieces from virtually all the most galleries, there was previously just algorithm is overridden, and the blinds great artists. Most of the building’s a maximum opening angle for each sea- can move to their fully open position. 40-plus galleries have glazed roofs, son of the year, with no account taken This also happens if the program and here the system regulates the of the Sun’s movement during the day. determines that the roof light will be light levels through coordinated As a consequence, blinds were often in shadow from an adjacent building control of picture lighting and the not opened as far as they could have or another part of the roof structure. rooflight window blinds. been, which unnecessarily restricted Since the blinds need to be closed The galleries’ individual Trend IQ the amount of natural light allowed during the hours of darkness, the controllers will only switch on the arti- into the galleries. program also calculates the hours ficial lighting if the optimal illumina- The new blind-control program of sunset and sunrise. tion level cannot be achieved with overcomes this limitation by using the Light levels in each gallery are mea- natural light alone, through control time and date to continually calculate sured by several sensors, and the gallery of the blinds. Generally, a gallery has a the changing position of the Sun. From controller works from an average of three-circuit lighting track: one com- this, it repeatedly computes maximum readings taken over the previous min- prising blue lights simulating daylight, and minimum safe opening limits for ute. It also reacts to high or low instan- and another made up of conventional each set of blinds, taking into account taneous values, by disabling or enabling clear lamps. The first come on if the their orientation and slope. The limits the artificial lighting. In addition, it uses average light level falls to a preset value for each set are updated in rotation these values to calculate cumulative and, if this is not sufficient, the second every two to three minutes. Calculations light exposure levels, which should set is switched on as well. The third are made to a resolution of less than 1°, not exceed 12,500 lux-hours per week. circuit is used for after-hours patrol although blind movements are made Ideally, the pictures are displayed lighting. in increments of 2.5° or 5°. with daylight to an average of 200 lux. 28 PAPYRUS SUMMER–FALL 2010
  • 31.
    The motorized externalblinds are This can be summarized as follows: XNC controller, which has sufficient controlled via the BMS to ensure the software capacity to carry out the exten- • If daylight drops below 150 lux, the light level is between 150 to 210 lux. If sive trigonometric calculations. This com- blues turn on (1st stage). daylight is insufficient, the blue lens municates with the galleries’ existing light fittings are switched on to provide • If the combined light level of day- controllers via the BMS network. an additional 60 lux. If the light level light and blues drops below 150 lux, The program, which was tested using is still insufficient, the clear lens light the clears turn on (2nd stage). an architectural software package that fittings provide a further 90 lux. • If the light level exceeds 210 lux, includes solar simulation, is initially the clears turn off first. being applied in seven galleries. It is expected to be rolled out to the • If the light level continues to exceed remainder later this year, which will 210 lux, the blues turn off. require the installation of a second • As a safety function, if light levels IQ3xcite XNC controller. Together, exceed 350 lux, all picture lighting the two controllers will calculate and is turned off. supply settings for around 100 sets of blinds of varying design and orienta- • If light levels fall below 90 lux, then tion. The energy savings that result both stages of lighting are turned on. could be significant. The first elements of the National There are delays built into the strat- Gallery’s Trend BMS were installed egy, in order to prevent the lighting more than 20 years ago. Today, it incor- cycling on and off due to sudden porates over 100 IQ controllers, all changes in light level, as might be operating within a single fully inte- experienced on a bright sunny day grated system. A number of graphics- with fast-moving clouds. based supervisors provide the Gallery The new blind-control strategy was engineering staff with access to control devised by building services consultant settings and system-monitored data. Andrew Reid & Partners which, like Trend Control Systems Ltd., has worked Steve Vandyke is Head of Technical Services One of the galleries, employing both with the National Gallery for many years. at the National Gallery on Trafalgar Square natural light and artificial illumination. It has been installed into an IQ3xcite in London. MESSAGE FROM THE PRESIDENT MOT DU PRƉSIDENT MENSAJE DEL PRESIDENTE CONTINUED FROM PAGE 4 SUITE DE LA PAGE 4 VIENE DE LA PƁGINA 4 institutions in order to reduce the num- viduels; donc, je pense aussi qu’ils peu- esta situación en sus propios paĆ­ses? ber of separate museum bodies. Has vent dĆ©cider que toutes les institutions El Departamento de Cultura, Medios anyone had experience of this in their culturelles dans la ville fassent un appel de Comunicación y Deporte del Reino own countries? The UK Department of d’offres commun pour les services des Unido ha pedido detalles de las fechas Culture, Media and Sport has requested installations pour que, par exemple, de terminación de nuestros contratos details of all end dates of our indi- il n’y ait qu’un contrat de nettoyage individuales, asĆ­ que tambiĆ©n sospecho vidual contracts, so I also suspect that unique dans tous les musĆ©es et galeries. que van a intentar que todas las insti- they may try to make all the cultural Est-ce que ceci est arrivĆ© Ć  l’un de nos tuciones culturales de una ciudad institutions within a city jointly tender membres? soliciten sus servicios de mantenimi- their facility services—this might Cette confĆ©rence sera l’occasion ento juntos—para que tengamos, por mean that we have, for instance, a d’échanger des idĆ©es et de dĆ©velopper ejemplo, un solo contrato de limpieza single cleaning contract across all un partenariat Ć©ducatif entre les en todos los museos y galerĆ­as. ĀæHan museums and galleries. Has that membres, ce qui nous permettrait experimentado esta situación algunos happened to any of our members? de nous entraider et de partager des de nuestros miembros? This conference will provide an expĆ©riences. Donc, assurez-vous que Esta conferencia nos brindarĆ” la opportunity to exchange ideas and vous seriez lĆ  – mĆŖme si cela signifie oportunidad de intercambiar ideas y develop a learning partnership amongst que vous deviez Ć  la considĆ©rer desarrollar un equipo de aprendizaje members, allowing us to help each other comme temps de vacances! entre los miembros, que nos permita and share experiences. So make sure ayudarnos y compartir experiencias. you are there—even if it means you AsĆ­ que no falten—”aun si tienen que have to treat it as vacation time! ocupar ese tiempo como vacaciones! PAPYRUS SUMMER–FALL 2010 29
  • 32.
    Facility Managers Lead the Move to Green with Improvements in Energy Efficiency Thomas A. Westerkamp By Thomas A. Westerkamp F acility managers are challenged to meet increasing The best place to start documenting the power-distribution energy demands while holding the line on energy system layout is at the incoming power service entrance. This costs. This article discusses key cost elements, load is where the power company’s high-voltage service enters profiling, sub-metering opportunities, links to other build- your facility, passes through a high-voltage switch in your ing management systems, energy efficiency checks, and substation, then continues through a transformer where training opportunities, as well as the rewards for successfully the voltage is stepped down to the highest voltage distributed meeting the difficult challenge of being green. in your facility—typically 440 volts. From the main switch gear, the power-distribution system branches out into feeder circuits. Typical groupings of power users are: boiler and Load Profiling steam systems; building heating and cooling; compressed Energy consumption in the U.S. has increased almost air; data centers; hot water; lighting; plant operating equip- without interruption for more than four decades, from ment, motors and drives; refrigeration; and security systems 67.8 quadrillion BTU in 1970, to a peak of 101.5 quadrillion and alarms. Each feeder may be divided into several branch BTU in 2007 before the global recession—and even in circuits, which provide electrical power to individual equip- 2009, was over 94 quadrillion BTU. Since the 1950s, U.S. ment items such as HVAC air supply and exhaust drive energy consumption has exceeded production. We are now motors, lighting, heating devices, computer data centers, dependent on foreign sources for over 20% of our energy. and operating equipment. The layout should show each The energy users in your facility are the many standard circuit and the equipment served, along with nameplate and special equipment components arranged in a one-of-a- information, such as volts, amps, horsepower, cycles, watts, kind, unique physical layout, linked together by the power design factor, and the like, for each equipment item. distribution system. In many facilities, especially older ones, As an alternative to preparing a blueprint schematic of the exact arrangement is not well known, because the dis- your power-distribution system, you can use a CAD system tribution system blueprints or schematics have either been software package—one that has electrical symbols in the lost, or systems have been altered piecemeal over time with- database, such as AutoCAD or Microsoft Visio—and create out the alterations being documented each time. This is a an up-to-date schematic using it (Figure 1). These tools have very common, but nonetheless serious, disadvantage to the distinct advantage of offering quick and easy revision. facilities manager seeking opportunities for improvement: Thus, if you add to the system or move equipment around you have to know what you have before you can make it as needs change, you have a much better chance of keeping better and quantify benefits. Measurement must come the layout up-to-date, because it is so much easier and quicker before control. to do. The discipline of entering each field change when it Do you know where the top energy-users are located in is implemented must be maintained by making this docu- your facility, and how much energy they consume? Even if mentation a mandatory part of the work order authorizing you’re fairly confident about this, an annual energy check the change. may be in order to guard against creeping change. The first step to start, or upgrade, an energy-monitoring system is to get together all available system layout information. It Power-Monitoring Equipment Reveals is necessary to check all information by walking the system that Measurement is Essential to Control and marking up the old piping and electrical distribution Power savings come from two sources: demand-rate reduc- system schematics, noting additions and modifications. If tion and lower energy consumption. Demand rate is the rate you do not have the original drawings, there are standard per kilowatt-hour (kw-hr) charged by the power company. power-distribution system layout sheets, available from your This rate is based on the peak demand that occurred during electrical equipment vendor or your electric utility company the period in which your rate was calculated. The higher representative, which you can use to simplify the process that peak demand was, and when it occurred, determines and ensure that all key components are considered. the rate you pay your electric utility company for all of your 30 PAPYRUS SUMMER–FALL 2010
  • 33.
    power during theensuing contract period. Energy consump- sub-metering on each feeder circuit. These sub-meters will tion is the cumulative kw-hrs consumed during the billing show which feeders generate the greatest lighting, motor period. The more kw-hrs consumed, the higher the bill. and heating loads. Sub-metering individual branch loads Both the rate and consumption are controllable expenses, will identify the specific electrical equipment from which the and the resulting energy cost can often be reduced by most potential savings may be gained. An individual motor 20% with proactive power management, as opposed to low load can be measured by simply clamping an ammeter, also or no power management. Other benefits are shown in called a tong tester, on each of the phases at the line switch. Figure 2. Lowering your peak demand, or shifting your peak By sorting the loads in descending order, you can create demand away from the power company’s peak demand time a Pareto analysis—for example, 80% of the load may be of day, lowers your rate. Lowering consumption by installing concentrated on 20% of the equipment—that highlights more energy-efficient electrical devices—for example, replac- the best savings opportunities. ing incandescent with compact fluorescent lamps—also helps. Energy consumers want to improve benefits from energy So does cleaning fixtures and going back to lower-watt bulbs consumption, reduce lifecycle costs, and keep the system that were used before the fixtures got dirty. reliably consistent in providing a light-, temperature-, and The next step, after system documentation, is to upgrade humidity-friendly environment for the art collections. Fac- the power-monitoring program to evaluate the system you tors you want the meters to identify are peak demand amount have documented, and to assess opportunities. Where would and time of day, the source of the greatest demands, and monitoring likely provide the most benefit? The main service disturbances that might cause critical interruptions, envi- entrance switch gear is usually metered by the power com- ronmental problems or power-quality problems. Power pany—or in-house, if you generate your own power. These meters basically measure volts and amps and convert the sources provide a reading of the overall load, but don’t readings internally to other metrics such as power factor: a detail the individual loads that contribute to it. To obtain a measure of the efficiency of the power delivered. The lower breakdown, install some form of temporary or permanent the power factor, the greater the losses (reactive kilovars), Lowering consumption has cost and other benefits: • Museums are showing their energy usage on a website dashboard to demonstrate tangible evidence of their contribution to a better environment. • The U.S. Energy Policy Act of 2005 (PL 109-58) provides tax deductions for design and instal- lation of energy-efficient commercial building systems, including lighting, heating, cooling, ventilating, hot water and building envelope systems. • The U.S. Energy Independence and Security Act of 2007, H.R. 6, calls for incandescent light bulb phase-out and replacement by more energy-efficient compact fluorescents, halogens, and LEDs. The phase-out, to be completed by 2020, could save $18 billion annually in electric bills in the U.S. • According to the U.S. Department of the Environment, converting to NEMA premium motors would save 5,800 gigawatts and prevent the release of 80 million metric tons of carbon into the atmosphere over ten years—or the equivalent of keeping 16 million cars off the road. Figure 1: Power distribution schematic. Figure 2 PAPYRUS SUMMER–FALL 2010 31
  • 34.
    and the moreyou pay for the same useful power. For If you have introduced new CAD electrical-distribution example, induction motors tend to lower power factor, software, now is a good time to broaden familiarity with it, sometimes to as low as 80%. Induction motor circuit power so that more than one person in the organization can update factor is corrected toward unity (PF = 1, or 100%) by instal- it or retrieve sections for planning purposes. ling variable-power factor-correction capacitors in the circuit, If you order new power-monitoring software and sub- which automatically adjust power factor for that circuit load. metering equipment for your upgraded system, it is very Depending on the variations read by the meters, power factor important to get complete sets of operating and maintenance can be increased to the high 90s, saving a lot of energy and manuals, including parts lists and preventive maintenance at the same time reducing the peak demand, if related plans, in sufficient copies. To ensure this, list these items equipment is the cause of the peak demand. This adjust- in the purchase order specification as a separate line item. ment, therefore, has the potential to save both the total After the order is placed, it may be very hard to go back and amount used and the rate paid. get the missing documentation. Specific vendor training is The same meters that detect peak demand and power another important line item in your specification. Every- factor can be used to track disturbances and energy cost one has had the experience of the vendor coming in for by department, tenant, process or output. They can also a day or two, when the software and equipment are new, provide 24/7 load profiles, and automate load control and to provide some training—but some of the features may load management. By tying the system into your building not be used for quite a while. When the maintenance folks automation system (BAS), you can more easily monitor attempt to use those features later, they often find that they both systems. If the construction specifications included have forgotten the training. interoperability standards such as BACNet (ASHRAE’s To prevent this, and to get the most from vendor training interoperability process standard), you can integrate several offerings, smart managers have the training done in at least systems spread over one or more buildings, campuses, or two phases. The first phase is introductory training that rep- states, so that all systems—and the total energy consumption resents a first contact with the new material. It includes an of all facilities—can be monitored from one central point. overview of the whole system and detailed training by example Meters have integrators that store readings, so that in on the features that will be used first. Each trainee should the event of a power interruption, you don’t lose any data. have plenty of hands-on practice with the new equipment When power returns, the stored data is accessed and logged. at this point. Between the first and second training sessions—perhaps Software Opportunities a month or so apart—each trainee should keep a notebook and log any problems, glitches and things they don’t under- Power-management meters and sub-meters comprise the stand. Of course, if the new equipment includes some fairly system hardware. Coupled with the software, you have a high-tech features, you’ll want to add a service agreement powerful energy-data collection, management and control to the bill of material, so that you can get online or telecom system. Each meter represents a measurement and control help when you need it for urgent problems that cannot wait point. The data from that point is fed back to the computer, for a second round of training. converted into the various metrics you are measuring, and The second training session—and other future sessions— is displayed on a real-time graphic display at one or several review the entire system, with concentration on the features control points. The graphic shows your power-distribution that are most important in your installation. Sometimes it system. Each control point is represented symbolically and, is hard to get the vendor to depart from a canned training next to the symbol, a data display box registers the real-time program. Their instructors are taught specific course variation in kilowatts at that point, as well as other metrics content, and are often not prepared to depart from it in that you have selected. The meters are scalable, so you can order to resolve your specific problems. It is good to know add more metrics and read them at more or less frequent this ahead of time, and make your interest in site-specific intervals as required. training known in advance, to avoid unrealistic expecta- tions and disappointments, and ensure that the training Systems Training Needs does meet your needs. Having completed the specification for power-distribution Energy conservation spans all building systems, structural, upgrades and monitoring, that spec list is also your list mechanical and electrical. An energy-efficiency check can of very important training opportunities. You can use the reveal many opportunities for tuning up your facility. A updated schematic to bring all the electricians and elec- checklist of items that influence energy efficiency is shown tronic technicians who work on the system up-to-date on in Figure 3. Facility managers can use this list as a starting the current layout, and point out the current load-balance point to focus their energy-improvement efforts. Each faci- situation: where there are bottlenecks in the capacity that lity is unique, and will have other opportunities that can be limit further loads on that phase, feeder or branch, and added to customize the list. Repeated annually, this energy- where further loads are okay. You can also begin, just by efficiency improvement check will provide details that help inspection of the load distribution, to make improvements to prioritize your continuous improvement efforts. to reduce the load—such as premium efficiency motors A coherent energy strategy, based on detailed knowledge and low-wattage lamps replacing older less-efficient ones. about your energy load and rate basis will ensure that your 32 PAPYRUS SUMMER–FALL 2010
  • 35.
    facility finds iteasier and more eco- nomical being green. You will achieve Energy Efficiency Improvement Checklist all of your energy conservation objec- ā–” Refrigeration system lines/valves properly Boilers, Steam and Electric tives: reducing consumption, preserving insulated Generation resources, reducing pollution, and ā–” Time, temperature, turbulence and ā–” Ice storage used for peak-demand lowering lifecycle costs. There is also oxygen balanced for optimum efficiency optimization a public relations benefit in keeping ā–” Cogeneration to optimize fuel use ā–” Pumps/motors/blowers/drives checked employees and visitors aware of your with vibration analysis ā–” Steam/electric load vs. capacity balance good stewardship. optimized ā–” Belt drives are tightened, belts replaced per annual schedule ā–” Boiler feedwater treatment optimized ā–” Water sub-metering used to optimize Tom Westerkamp is President, Work ā–” Annual tube check/cleaning, boiler water use Management Division of the Westerkamp re-insulation completed on schedule ā–” Hot water temperature set optimally Group, LLC. He is a consultant, speaker, ā–” Annual pressure relief valve author, co-founder and former CEO of checks/rebuilds per schedule ā–” Hot water tanks/lines insulated Productivity Network Innovations, LLC. ā–” Steam pressure optimized/no leaks ā–” Water heaters off when not needed His book, Maintenance Manager’s ā–” Economizers optimizing heat recovery ā–” Special purpose areas; e.g., kitchen, lab, Standard Manual, 3rd Edition, 2007, is cold storage optimized for HVAC and ā–” Boiler blowdown timing/amount as distributed by BNi Books, Vista, CA. The R control 4th Edition is scheduled for publication recommended in Fall 2010. He can be reached at ā–” Steam/condensate piping insulation Compressed Air tawest@westerkampgroup.com. inspected/repaired annually ā–” Compressor cycling optimized per baseline ā–” Condensate return recovery % ā–” Lines and valves checked, and leaks fixed ā–” Traps/strainers cleaned/checked ā–” Pressure regulators/filters/oilers ā–” Condenser tubes cleaned per annual cleaned/checked per schedule Other Resources schedule ā–” Condensate blowdowns completed per ā–” Electrical distribution/contacts checked schedule • American Society of Heating, with thermal imaging and cleaned Refrigeration, and Air Conditioning ā–” Air tools cleaned, no line leaks, and annually Engineers (ASHRAE) operating efficiently ā–” Motors blown out per schedule www.ashrae.com ā–” Multi-compressor systems cycling most ā–” Premium motors used efficiently • EPA Energy Star ā€œGuidelines ā–” Power factor optimized by metering and for Energy Managementā€ adjustable capacitors Lighting www.epa.gov ā–” Sub-metering employed to identify high ā–” Lighting levels optimal for space use • Institute of Electrical and energy areas per standards Electronic Engineers (IEEE) ā–” Net-metering sell-back program used to ā–” Replace incandescent with compact 3 Park Avenue, 17th Floor optimize energy costs fluorescent lamps New York, NY 10016 ā–” gram used to optimize energy costs ā–” Clean fixtures for high efficiency per 212-419-7555 annual schedule www.ieee.org Building Heating, Ventilating and ā–” Optimal use of natural light, occupancy Air Conditioning sensors • International Association of ā–” High-efficiency lamps used in high-bay ā–” Insulation adequate Electrical Inspectors (IAEI) areas ā–” Window/door seals working P.O. Box 830848 ā–” Wall/ceiling coatings optimize reflectance Richardson, TX, 75083-0848 ā–” Proper air supply/exhaust balance 972-235-1455, ā–” Proper air-volume change rate Other www.iaei.com ā–” Proper thermostat settings used ā–” Facility-wide annual lube program ā–” Building automation-systems controls optimizes lube quality/quantity/frequency • National Rural Electric Co-op Association (NRECA) resets ā–” Annual PM/PdM system coverage and ā–” Proper filter maintenance scheduled schedule compliance >95% 4301 Wilson Blvd. Arlington, VA 22203 annually ā–” Total lifecycle management practiced. ā–” Sunny-side window shades closed Compare alternative purchases using 703-907-5500 Lifecycle Cost Analysis www.nreca.org ā–” Zones/heating/cooling not competing ā–” Investigate renewable energy sources; ā–” Economizers returning seasonal hot/cold • U. S. Department of Energy e.g., solar air temperature www.doe.gov ā–” Your facility-specific checkpoints: ā–” Use of variable air volume, variable-speed • Westerkamp, Thomas A., drives instead of dampers ā–” —————————————————— Maintenance Manager’s Standard ā–” Peak-demand reduction opportunities ā–” —————————————————— Manual checked annually ā–” —————————————————— 3rd Edition ā–” Chilled water system operating efficiently BNi Publications, 2007 ā–” —————————————————— ā–” Cooling towers/spray nozzles cleaned www.pninc.com per annual schedule ā–” —————————————————— Figure 3 PAPYRUS SUMMER–FALL 2010 33
  • 36.
    Become a Memberof IAMFA And get a friend to join On behalf of the membership and Board, we invite you Membership Opportunities to join with other museums and cultural organizations Join the IAMFA at any of the following levels and enjoy throughout the world in becoming a member of the only full benefits of membership: organization exclusively devoted to museum and cultural facility administrators: the International Association of Regular Member — $150 annually. A regular member Museum Facility Administrators (IAMFA). As a member, holds the position of principal administration in direct you will join a growing list of museum and cultural facility charge of the management of facilities, and represents administrators in their efforts to provide a standard of their institution(s) as a member of the association. excellence and quality in planning, development and design, Associate Member — $50 annually. An associate member is construction, operation and maintenance of cultural a full-time facilities management employee (professional, facilities of all sizes and varieties of programming. administrative or supervisor), below the level of the The Association currently has representation in several facility administrator of the member association. countries on three continents. Our goal is to increase Affiliate Member — $50 annually. An affiliate member is membership in institutions throughout the world. any full-time employee of a member institution who is not directly involved in the facilities management department. Your involvement in IAMFA will continue the growth of the organization and provide you with excellent Retired Member — $50 annually. A retired member is educational and networking opportunities. As your retired, and no longer involved in facilities management. colleagues, we look forward to welcoming you to Subscribing Member — $300 annually. A subscribing membership in IAMFA. member is an individual, organization, manufacturer of Cordially yours, supplier of goods services to the institutions who ascribes The Board of the International Association of Museum to the policies and programmes of the Association, and Facility Administrators wishes to support the activities of the Association. Send in your membership dues by using the convenient form below. Membership payments and conference registration can also be made online at www.IAMFA.org Don’t forget to make a copy to give to a colleague. Ā” YES! I would like to join IAMFA as a: ā…Ŗ Regular Member $150 ā…Ŗ Retired Member $ 50 ā…Ŗ Affiliate Member $ 50 ā…Ŗ Subscribing Member $300 ā…Ŗ Associate Member $ 50 ā…Ŗ I am interested in joining. Please have a member contact me. Institution: __________________________________________________________________________________________________________________ Name: ______________________________________________________________________________ Title: ________________________________ Address: ____________________________________________________________________________ City: _________________________________ State/Province: _______________________ Zip/Postal Code: _______________________ Country:_____________________________ Phone: _____________________________________ Fax: ____________________________________ E-mail: ______________________________ Please remit to: ALL FEES ARE PAYABLE IN U.S. DOLLARS International Association of Museum Facility Administrators P.O. Box 277 ā…Ŗ I enclose a check in the amount of $ ____________________ Groton, MA 01450, USA ā…Ŗ Please invoice me Website: www.iamfa.org 34 PAPYRUS SUMMER–FALL 2010
  • 37.
    Benchmarking: A Comparisonover Time By Stacey Wittig T his year marks IAMFA’s tenth benchmarking exercise. Electric Cost per GSF The 2010 report will soon be released, and the longevity The median cost per GSF for participants reporting in 2001 of the exercise begs the question: how have we was 1.73 USD. That grew to 1.69 USD for 2006, and 2.28 USD changed? Have we as a group become more efficient over for 2009. These figures do not tell the whole story without the years? showing the cost per kWh. For instance, the average Retail To answer those questions, it is important to recognize Price of Electricity to Commercial Customers of .0789 USD some important variables. First, data collection and report- per kWh grew to .1036 per kWh in 2008, according to the ing has changed over the years. Initially, Facility Management U.S. Energy Information Administration. UK Power reports Services Ltd. managed the study. Their first questionnaire that the cost of electricity in Europe ā€œfluctuates wildly from was issued in April 2001, and included information from state to state.ā€ Unfortunately, the 2001 IAMFA Benchmark- ā€œthe most recent 12-month reporting period,ā€ measuring ing Report did not capture the cost of electricity per kWh data for the year 2000. They averaged the data collected in or electricity consumption. their reports. When Facility Issues took over the study for The median cost per kWh in the 2006 IAMFA Bench- the 2005 report, data was compared to the median, rather marking Report was .0836 USD, compared to .113 in 2009. than the average. Median electrical consumption per GSF was 21.86 kWh in The questions have also changed over the years, and 2006 and 23.73 kWh in 2009. At the 2009 Best Practices some of the data points were not collected in the early days. Workshop, participants noted that increased electricity For instance, comparisons of electric consumption in kilo- usage during times of energy-saving practice implementa- watt hours (kWh) per gross square foot (GSF) over time tions could be due to the increased use of computers and might better answer the efficiency question above. We video and audio components in exhibitions. have early data on electricity costs, but not consumption. The second variable is, of course, inflation. I have adjusted the costs shown here based on inflation figures Total Utilities Cost per GSF from www.dollartimes.com.* Perhaps others have a more The 2001 report shows that the adjusted median cost for accurate method. utilities was 2.48 USD per GSF. This rose to 3.05 USD in In 2001, facility administrators reported that the 2006, and 3.75 USD in 2009. important issues facing them were: • funding for lifecycle replacement of building elements, Building Maintenance Cost GSF • doing more with less, According to a 2001 Papyrus article, the 2001 report showed the average cost of building operations at 11.47 USD per • customer satisfaction/service, and square foot. When you multiply that by 1.25 for inflation, it • strategic planning. adjusts to 14.34 USD. The 2006 report shows ā€œTotal Oper- ating Costsā€ at 14.91 USD per GSF x 1.10 for inflation, Some things haven’t changed much. Elements that have adjusted to 16.40. The 2009 report shows the median total changed are outlined below. operating cost down to 14.87. Change in Temperature and Relative Relative Humidity Temperature Humidity The most drastic change in temperature and relative humid- 2001 Average °F °C (%) ity settings is seen in winter average relative humidity (see Exhibition Areas 70 21 48 Figure 1). The group’s median for average relative humidity Office/Administration Areas 71 22 46 dropped from 48% in 2000 to 45% for permanent display areas, but then was back up to 47% in 2009. It will be inter- Conservation/Lab Areas 70 21 47 esting to watch for changes in that data table in the upcoming Collection Holding Areas 69 21 49 2010 report. Average temperatures crept up slightly to 72°F Building Mechanical Areas 72 22 47 during the summer months. Public Amenities 71 21 46 Underground Parking 63 17 *According to www.dollartimes.com, $1.00 in 2000 had the same Library 70 21 46 buying power as $1.25 in 2008 (data from the 2009 report.) Annual inflation over this period was 2.81%. Figure 1: 2001 Temperature and Relative Humidity PAPYRUS SUMMER–FALL 2010 35
  • 38.
    Median Cost ofCustodial Services (adjusted for inflation) was up to 96%. Of those who had a plan, 81% reported 2001: 1.93 USD per SF using the plan due to bomb threat or severe weather. It is 2006: 2.68 USD per SF interesting that only 78% of those institutions with a disaster 2009: 2.85 USD per SF recovery plan had practiced it within the previous 12 months. Area Cleaned per FTE Worker CMMS 2001: 26,600 square feet In 2002, Computerized Maintenance Management Systems 2006: 18,960 square feet (CMMS) were used by 53% of participants. By 2009, almost 2009: 18,683 square feet 90% of participants used CMMS for repair work requests. ā€œDisaster Managementā€ changed to Stacey Wittig is the Marketing Director for Facility Issues. Places are still available for observers at the 2010 ā€œBenchmarking Practices ā€œDisaster Recoveryā€ to ā€œEmergency and Learning Workshop.ā€ www.facilityissues.com Preparedness Planā€ In 2002, participants were asked if they had an up-to-date disaster management plan. 83% said yes. In 2009, that figure Reserve this space to Please contact the advertise in a future Editor of Papyrus for details issue of Papyrus Past issues of Papyrus can be found on IAMFA's website www.IAMFA.org 36 PAPYRUS SUMMER–FALL 2010
  • 39.
    Reflections on Papyrus By Pierre Lepage Pierre Lepage P apyrus: not a word you’d have in produced mostly once a year—primarily structured form of written communi- the back of your mind—or have to promote the annual conference. It cation with members. Accordingly, at an opportunity to use in daily consisted of a two-pager mailed out the 2001 Washington, D.C. conference, conversation—unless you happened to IAMFA members. There was no then-President of the Association, Peter to be the editor of IAMFA’s newsletter. real commitment in these early years Fotheringham, directed the Board to Papyrus is actually a type of paper, to produce a journal; the energies of revamp the Papyrus newsletter in order first manufactured in Egypt 5,000 years the Board were directed to keep the to provide IAMFA with a true journal ago. Processed fibers from the stem Association alive, and to ensure the highlighting the achievements of the of the three-meter-tall papyrus plant, holding of an annual conference. At Association and its members. The inten- which grew along the banks of the Nile, times, the newsletter might include an tion was to give members a means of provided a writing surface that was article written about facilities issues or sharing their initiatives for the benefit easier to produce and handle than the achievements, but this was largely left of others, while also promoting best parchment made of animal hide. The to the goodwill of members. practices and keeping members in plant was also used in the making of The first annual conference held touch with activities at the regional boats, mats, ropes, sandals and baskets. in Europe—the highly successful 1998 level. The goal in implementing a well- The heritage of this medium as conference in Edinburgh, a venue out- structured and professional journal a communication tool—along with side North America, with members was not only to promote IAMFA, but IAMFA’s mandate of promoting knowl- from five countries in attendance— was also a means of encouraging new edge and communication among mu- awakened members to IAMFA’s poten- members to join the Association. To seum facilities professionals—made tial. For perhaps the first time, members achieve those goals, Papyrus had to Papyrus the ideal name for IAMFA’s realized that they truly belonged to an include articles dealing with the nuts newsletter. international organization. From then and bolts of facilities management, the The Papyrus newsletter evolved in on, there was a major change in how articles had to be credible and pro- a way that parallels IAMFA’s growth. IAMFA conducted its business and fessional, and the journal had to be It takes time to build an organization membership activities. The annual con- published with consistency at regular from an informal group of a few like- ference began to include an annual intervals throughout the year. As minded people, into an internationally benchmarking exercise, making the IAMFA’s newly elected Secretary, recognized organization. And let us membership more active and partici- and Editor of Papyrus, I was the one not forget that this non-profit and patory. The position of Vice-President, mandated to make it happen. unsubsidized organization is managed Regional Affairs was created, with the I remember taking the opportunity by a Board of Directors composed of election of Carole Beauvais, who suc- of having IAMFA members captive at facilities management professionals. cessfully promoted IAMFA, and was the conference to obtain commit- These elected Board members volun- instrumental in initiating a number of ments for articles for the new version tarily dedicate time over and above their new regional chapters. This expansion of Papyrus. Upon returning from the regular duties at their respective insti- brought a tremendous need to open conference, the structure of the journal tutions, in order to maintain IAMFA’s up communication with members in was sketched out, Sheila and Neena viability. It is worthwhile remembering, order to share achievements and acti- Singhal of Artistic License/Phredd as well, that these individuals are gen- vities initiated by members within their Graphix were approached to discuss erally from different countries, conti- respective chapters. Around the same design and layout options, determine nents, and even different linguistic time, Richard Kowalczyk created and feasibility costs, and come up with a backgrounds. All that being said, the posted the IAMFA website: a highly realistic production schedule for three stature of the Association and Papyrus successful medium that allowed mem- issues in 2002. today, after only 20 years, is a remarkable bers to remain connected with their The first edition of the new Papyrus achievement. Association on an ongoing basis. came out in February 2002, designated Let me recount a little bit of history This expansion and evolution of the as the Winter 2002 issue, volume 3, in the evolution of Papyrus. During its Association’s business and activities at number 1. The result was a 20-page first ten years or so, the newsletter was the end of the 1990s warranted a more issue printed in two colors, promoting PAPYRUS SUMMER–FALL 2010 37
  • 40.
    the 2002 12thannual IAMFA confer- ties on a daily basis, and to promote • First issue introducing the ence in London, and including eight better management practices in cultural production of an article in three articles—two of which were submitted facilities at an international level. languages: English, French, from sources outside the Association. I have been retired now for five years, Spanish The Board of Directors took the and it is interesting to observe from a Winter 2008 opportunity represented by the re- distance the quantum leap that IAMFA • First glossy full-colour issue vamped Papyrus to promote IAMFA and Papyrus have made over the past Spring 2009 more heavily, and to seek the recruit- 10 years. It is more evident all the time ment of new members. For that pur- that this organization has a solid raison • First issue with more than 40 pages pose, the first print run was 1,000 copies d’être. I also believe that the effort Summer 2009 with 874 mailed to individual cultural invested in promoting effective com- • First issue with paid advertising institutions in 46 countries. munication with the membership— Winter 2009 Since that first issue of the revived primarily through Papyrus—has gal- newsletter, Papyrus has evolved and is vanized the fundamental base of the • First issue with a puzzle page still published three times a year. It has IAMFA organization, and that it con- Spring 2010 become a reflection of the Association tinues to promote the professionalism of that it serves, which is why Papyrus its members on an international scale. My best wishes to IAMFA and continues to evolve. It has become a In conclusion, let me highlight some Papyrus on their 20th Anniversary! truely professional communications fun facts about Papyrus: tool, meant to broadcast IAMFA’s man- Pierre Lepage is a former Secretary of • First revamped issue of Papyrus IAMFA and Editor of Papyrus, and is the date, to recognize its membership’s Winter 2002 retired Director of Property Management, achievements, to bring perspective Security, and Client Services for the to the challenges that facilities profes- • First issue with colour Canadian Museum of Civilization and sional must deal with in cultural facili- Summer 2007 the Canadian War Museum in Ottawa- Gatineau, Canada. 38 PAPYRUS SUMMER–FALL 2010
  • 41.
    Auckland Art GalleryToi o TĀÆ amaki Building Development Update By Patricia Morgan T hose of you who were at the 2005 it has unfolded over the past 22 months. IAMFA conference in Bilbao The following pictures provide a snap- may recall that I gave a presenta- shot of what we have achieved since tion on the major building development construction began. Auckland Art Gallery Toi o TĀÆ maki a Achieving what you can see in the was about to undertake. The focus was images has involved over 500,000 hours on the constraints and challenges of work onsite to date, with around 160 the site: its heritage/historical context personnel now working on the site on and location, as well as limited oppor- any given day. This does not take into tunities to increase the building’s foot- account the people involved in offsite print. It was in response to that pre- fabrication of the beautiful kauri soffits sentation that I was invited to host a or other aspects of the building. Over future IAMFA conference, which we 20,000 m3 of excavated material has are now well into planning—so mark been removed from the site to create your diaries for November 13–17, plant rooms—and above that, a full 2011 in Auckland New Zealand! lower ground level of mainly back-of- Back at the Guggenheim in Spain— house space. 5,000 m3 of concrete has or was it the Maritime Museum?—I been used on the site, as has 400 tonnes optimistically titled my presentation of structural steel. In creating the beau- ā€œAuckland Art Gallery 2009ā€, which tiful kauri ceilings and columns, 200 m3 was when we expected to re-open. of fallen New Zealand kauri timber has Well . . . it would be another three been used—a story in itself that I will years before work commenced on the save for another time!—and the glass site, as we suffered a number of delays walls of the north atrium, an innovative Auckland Art Gallery Toi o Tamaka. ĀÆ working through the consents process. tensioned faƧade system, will be the It was not until September 2008 that the largest in southern hemisphere. Hawkins me that there are 15 different faƧade construction team, Hawkins Construc- project manager Grant Thomas tells types in the building design! tion, was finally onsite and commenced work. With construction estimated to take around 30 months, and with a fur- ther three months for our opening exhi- bition installations and relocation inside the building, we are now expecting to re-open to the public in mid-2011. We were always determined that Aucklanders would be able to see the progress onsite as it occurred, as our ratepayers are funding 46% ($56M) of this $121M project. So one of the first things we did, as part of our commu- nications strategy, was to set up a web- cam from a building across the road. This gave people a very good overview of the northern end of the building, Key: where the major construction activity Red dotted line = boundary would occur (www.aagwebcam.com). Dark grey = heritage buildings This webcam, which renews every White & pale grey = new build 15 minutes, has given us an amazing record of the building construction as The site of the Art Gallery building. PAPYRUS SUMMER–FALL 2010 39
  • 42.
    September 2008: Demolitionof the 1970s November 2008: Demolition continues. November 2008: The remaining heritage building begins. buildings. May 2009: The new building starts to go up! September 2009: Twelve months into construction. March 2010: Roofs under construction—the race is on to make it July 2010: The roofs are going on! watertight! 40 PAPYRUS SUMMER–FALL 2010
  • 43.
    Materials for thebuilding have come south atriums; American white oak for will be a world-class art museum—the from a variety of sources, in order to the floors of the gallery spaces; and spe- largest building in New Zealand dedi- achieve the quality finish that has always cialized glass which was sourced from cated to the display of visual arts—and been fundamental to the project. These Europe, America and Asia, to provide we know life can only get better. include kauri wood from New Zealand the building with transparency and light, The benefits of the redeveloped art for the spectacular ceilings in the north and to enhance the connection between gallery can be seen at a glance in the atrium, the external canopies and the the adjacent park and cityscape. graph below. barrel vault ceilings of the daylit con- A fundamental component of the Although a key driver for this temporary gallery on Level 2; jura stone design that architects FJMT+Archimedia $121-million project was to seismi- from Germany for the exterior walls of presented to us at the concept stage was cally strengthen the 1887 building and the new build; Portuguese moleanos the building’s relationship with the park. to bring it up to building code stan- stone for interior walls in the north and Their early concept design captured dards, when we complete the project what has become a major aspect—the we will have much more than a stronger fourth dimension—of the building. building capable of withstanding seismic FJMT+ARCHIMEDIA The canopy of trees in Albert Park, activity. Not only will Auckland have a particularly the Pohutakawa trees, public art gallery that values its archi- formed the basis for the design of the tectural heritage and its unique site, soaring roof canopies of the north but we will also have an iconic con- atrium, which protrude beyond the temporary building appropriate to building to the east and west, forming house the country’s finest art collec- Roof concept design—FJMT+Archimedia. canopies over external areas adjacent tion—a collection of around 14,500 to the building. works. The juxtaposition of restored It is only in the last few weeks that and reinstated heritage and modern FJMT+ARCHIMEDIA the kauri soffits, which are being fabri- public exhibition spaces will combine cated offsite, have started to be installed to offer an enjoyable visitor experience —inch by painstaking inch. Although that enriches the understanding and only a few are yet visible in situ, due to meaning of art. the forest of scaffolding in the north We cannot wait to share with you atrium, it is already clear what a feature some of the stories of our building of the finished building they will be. redevelopment—be it the re-creation Recent site visits have given us an oppor- of the 1916 daylit gallery, the Maori tunity to get up close and personal to dimension of the building, the kauri Concept sketch for the building’s kauri the kauri soffits. story, or myriad other tales that have roof canopy. With 12 months to go before we open evolved with the building itself. to the public, there is no likelihood So do join us in November 2011 that life is going to get any quieter for in Auckland to see and experience us—but there is no doubt that excite- Auckland Art Gallery, Toi o TĀÆ maki a ment is mounting for Gallery staff! for yourselves! Our recent staff tour of the site drew an overwhelmingly positive response. Patricia Morgan is Manager, Business Just to be back together in one place, Support at the Auckland Art Gallery— Toi O Tamaki in Auckland New Zealand. ĀÆ instead of spread over four different Pat will host the 21st IAMFA Annual sites, will in itself be a relief. Fold in to Conference scheduled for November that the opportunity to work in what 13–17, 2011. Scaffolding in the north atrium. Installation of kauri soffit in the north The benefits of the redeveloped art gallery. atrium. PAPYRUS SUMMER–FALL 2010 41
  • 44.
    Regional Updates/Member News NewYork Chapter Update year. This success has put Ā© HAYES DAVIDSON AND HERZOG & DE MEURON pressure on our existing facilities and program. Different kinds of gallery spaces are need- ed to better display the works in the Collection. Film, video, photog- raphy and perfor- mance have become more essential strands of artistic practice, and artists have embraced View of the Tate Modern from the new technologies. south at dusk. Ambitious and imagi- native installations are now pushing traditional gallery Meeting of the New York Chapter at the Cooper-Hewitt National spaces to their limits. Design Museum. Switch Station and Oil Tanks: An Ideal Opportunity to Expand A chapter organizational meeting was held in New York City The opening of the Tate Modern in May 2000 was intended on June 16 at the Cooper-Hewitt National Design Museum. as the first stage in the development of the former Bankside The turnout was terrific, with representatives from several Power Station. It was always envisaged that the derelict oil organizations. tanks and the switch station to the south of the site could John Castle started off with a brief history of IAMFA, dis- eventually be integrated into the gallery. cussing chapter activities and annual conferences. Nancy The electrical switch station is still used to power a large Bechtol from the Smithsonian Institution then talked about part of the City and South London. EDF, which owns the her perspective on benchmarking. She was followed by Jeff station, is modernising its equipment so it will take up a Ridgeway, also of the Smithsonian, who discussed what bench- smaller part of the building. This provides us with an ideal marking means to him operationally. Finally, John got up opportunity to expand the Tate Modern, with the oil tanks again and showed what he presents to his Buildings Com- forming the foundation of the new building. mittee and Trustees regarding benchmarking, and what they need to know regarding facilities management at the A Transformed Tate Modern Winterthur Museum. It was clear to all what an important The expansion will create a less congested, more welcom- benefit benchmarking is to IAMFA members. ing environment. The exhibition and display space will be After a superb lunch of sandwiches and chips, there was almost doubled, enabling us to show more of our Collection. a question-and-answer session—more like an open-mike There will be more cafes, terraces and concourses in which moment—then a house tour of the Cooper-Hewitt. to meet and unwind. Jeff Ridgway and Mark DeMairo will work in concert on the next chapter meeting. In fact, two people volunteered COURTESY LOBSTER PICTURES LTD 2010, Ā© TATE their respective facilities to host a meeting. So it looks very encouraging that the New York City Chapter will become a very active player within IAMFA. U.K. Chapter Update By David Redrup The next U.K. Annual IAMFA meeting will be hosted by the Tate Modern on April 13, 2011. This meeting will focus on the exciting new project that will transform the Tate Modern. The Reasons for Transforming the Tate Modern The Tate Modern was designed for two million annual Live image feed of new building project at the Tate Modern, visitors. It now receives around five million visitors each July 15, 2010. 42 PAPYRUS SUMMER–FALL 2010
  • 45.
    Learning will beat the heart of the new Tate Modern, progress and changes that have occurred at our venues. It reflecting the Tate’s commitment to increasing public knowl- also gets us out of the office on a regular basis! Amazingly, edge and understanding of art. There will be a range of we already have a draft programme for delegates, although new facilities throughout the building for deeper engage- the guest programme is proving more challenging, as there ment with art: interpretation, discussion, private study, is simply too much choice! Nevertheless, we will focus on participation, workshops and practice-based learning. what can be humanly achieved and experienced within three–four days, but with the absolute prerogative to give Closer to the Community you a taste of what Aotearoa (New Zealand) is all about! The Tate Modern is part of the neighbourhood. Its presence Last month we met at MOTAT: the Museum of Transport has made a major contribution to the ongoing revitalisation and Technology. I am embarrassed to confess that it is many of Southwark, and it recognises the importance of building strong links with the local community. The Transforming Tate NICK SERVIAN Modern project will be a catalyst for engaging local audiences more deeply, and broadening access to the museum. The new development will continue to bolster the growth of the borough. A public walkway through the building will make possible a direct route from the City to the heart of Southwark. There will also be two new public squares to the south and west of the building. And finally, To the east, a new planted area will be created especially for the use of the local community and staff. Ā© HAYES DAVIDSON AND HERZOG & DE MEURON Kapa Haka group. PETER MORETH View of the Tate Modern from the southeast. New Zealand Chapter Update The Southern Alps. By Patricia Morgan Kia ora IAMFA members! NICK SERVIAN IAMFA 2011, here we (and hopefully all of you) come! The Auckland-based organising committee for the November 2011 conference—IAMFA’s ā€œcoming of ageā€ conference, its 21st—has been meeting and planning since the end of 2009. The organising committee is comprised of: Patricia Morgan (Auckland Art Gallery), Paul Ivory (Auckland City Council), Natalie Hansby (Auckland Zoo), Paul Evans (Voyager, NZ Maritime Museum), Bridgette Robinson (Museum of Transport and Technology) and Adam Taylor (Auckland Museum). We meet monthly at each venue in rotation, which gives us all an opportunity to refamiliarise ourselves with all the Alfresco dining in Wellington. PAPYRUS SUMMER–FALL 2010 43
  • 46.
    years since Ivisited MOTAT—not since my adult sons were young, and fascinated by all things mechanical (how simple life was then!). What a difference and what a great venue for you all to visit and to be charmed by! The fact that it is right next door to the Auckland Zoo means you will enjoy a wonderful day at Western Springs, visiting both of these absorbing venues! Meetings at the Auckland Art Gallery are far less inter- esting at the moment, as the majority of Gallery staff are housed in a Council highrise. Thankfully, however, we are within five minutes of the Gallery building site—and before too long the organising committee will be able to have a guided tour of what is very quickly becoming a recognisable art gallery. (Check out the story on progress elsewhere in Papyrus.) Front entrance of the Baltimore Museum of Art. We are currently considering what we can present you with at the San Francisco conference, in order to whet your appetites and make a trip to Auckland next November 2011 annual conference in San Francisco, where they will get a a ā€œmust-doā€ in all your diaries. I am not sure we can reach chance to meet up with old friends and participate in the Joe’s poetic heights—the bar has been set rather high—but all the festivities the planning committee has planned! The we will do our best! In the meantime: a few images of our next Washington, D.C.-Baltimore Chapter meeting will beautiful country to capture your imagination, so that you take place in January 2012. will start preparing your travel business case! Haere rĀÆ . a New England Regional Chapter Meeting On June 14, members of the New England Regional GARETH EYRES KIERAN SCOTT Chapter met to tour the new 230,000-square-foot addition at the Museum of Fine Arts in Boston. The Museum is installing artwork in over 50 new galleries, and will display its ā€œArt of the Americasā€ collection in exquisite new case- work manufactured by Laboratorio Museotecnico Goppion, of Milan, Italy. A behind-the-scenes tour included the new 39,000-square-foot plant area which houses three new high temperature hot-water boilers, three 600-ton centrifugal chillers with plate and frame heat exchanger, and new 13.8 KV 8,000 amp electric service. Air-handling units are equipped with new ā€œfan wallā€ technology and gas filtration. Humidifi- cation is generated by four Cemline unfired steam boilers. The new glass-enclosed courtyard is heated and cooled by a combination of radiant floor and high-velocity air curtain The Bay of Islands. Auckland Central Business along glass. Group discussions included issues with new District. display vignettes, lighting, and energy consumption. The New Wing is scheduled to open in mid-November 2010. Washington, D.C.-Baltimore Chapter By Maurice Evans The Washington, D.C.-Baltimore Chapter will be holding its last chapter meeting for the year on August 26 at 11:00 a.m. The meeting will be hosted by Alan Dirican of the Baltimore Museum of Art. Vicky Kiechel who is an Architect AIA, LEED AP, a Professor at the University of Maryland, and a member of the environmental firm The Cadmus Group, will be the guest speaker for this meeting. Vicky will be giving a dynamic presentation on LEED Certification for a Facility Manager. The Chapter is looking forward to another great meeting, and will be returning to the Baltimore Museum of Art, where we held the annual benchmarking during last year’s conference. Members of the Washington, D.C.- Members of the New England Regional Chapter at the Museum Baltimore Chapter are looking forward to attending the of Fine Arts in Boston. 44 PAPYRUS SUMMER–FALL 2010
  • 47.
    Richard Day Retires DAN DAVIES By Maurice Evans One of the longtime members of the Washington, D.C.-Baltimore Chapter has decided to retire. Richard Day has decided to call it quits, and retired from the Smithsonian Institution on July 30, 2010 after working there for 37 years. Richard began his career in October of 1973 at the Smithsonian as a laborer. Since then, he has held numerous positions during his illustrious career, including building manager and facilities manager, and he retired as the Deputy Director of the Office of Facilities Management and Reliability. When Richard was asked what he will miss the most about IAMFA, he said it would be the annual conferences—although you can be assured that Richard isn’t leaving IAMFA! When asked what he plans to do with all of his free time, Richard said he is looking forward to sleeping in, spending more time with the family, and working on the farm. He will be truly missed by the Smithsonian. We all wish Richard the best as he starts this new chapter of his life, away from Richard at the IAMFA conference the hustle and bustle of the world of facilities and into the world of retirement. in 2006. See you in San Francisco! PHOTOS: JOE MAY The Garden Court at the Palace Hotel. The San Francisco Museum of Modern Art. The ā€œLEED Platinumā€ California Academy of Sciences. The Contemporary Jewish Museum. The de Young Museum. PAPYRUS SUMMER–FALL 2010 45
  • 48.
    IAMFA Members —Organizations National Gallery of Canada English Heritage Baltimore Museum of Art AUSTRALIA Ottawa, Ontario London, England Baltimore, MD Australian Centre for the Nova Scotia Museum Imperial War Museum Berkeley Art Museum/ Moving Image Halifax, Nova Scotia London, England Pacific Film Archive Melbourne, VIC Berkeley, CA Physical Resource Bureau The National Archives Australian National Maritime Ottawa, Ontario Richmond, Surrey Boston Athenaeum Museum Boston, MA Royal British Columbia National Galleries of Scotland Sydney, NSW Edinburgh, Scotland Museum Brooklyn Museum of Art Museum Victoria Victoria, British Columbia Brooklyn, NY National Gallery, London Carlton, Victoria London, England Royal Ontario Museum Camfill Farr National Gallery of Australia Toronto, Ontario North Grafton, MA National Library of Scotland Canberra, ACT Edinburgh, Scotland Chicago Children’s Museum National Gallery of Victoria FRANCE National Maritime Museum Chicago, IL Melbourne, Victoria Greenwich, England Cleveland Museum of Art BibliothĆØque Nationale Cleveland, OH National Library of Australia de France National Museum of Science Canberra, ACT Paris and Industry Columbus Museum of Art National Portrait Gallery London, England Columbus, OH International Council of Australia of Museums National Museums Liverpool Cooper-Hewitt, National Canberra, ACT Liverpool, England Paris Design Museum Steensen Varming New York, NY National Portrait Gallery Sydney, NSW NEW ZEALAND London, England Corporate Care Houston, TX Natural History Museum CANADA Auckland Art Gallery — London, England Cypress Security, LLC Toi o TĀÆ amaki San Francisco, CA Black & McDonald Limited Auckland Tate Ottawa, Ontario London, England Delaware Art Museum Christchurch Art Gallery Wilmington, DE Bureau de la transformation Te Puna O Waiwhetu University of Greenwich Christchurch, Canterbury London, England DFI Resources, LLC de la DGSDE Ottawa, Ontario Austin, TX The Wellcome Trust RUSSIA London, England Energy Maintenance Services Camfil Farr Canada Inc. Ottawa, Ontario Houston, TX A. A. Bakhrushin State UNITED STATES Ewing Cole Canada Science and Central Theatre Museum Philadelphia, PA Technology Museum Moscow Corporation AFS Chemical Filtration Exploratorium Ottawa, Ontario Group San Francisco, CA SPAIN Burlington, MA Canadian Museum of Facility Issues Civilization Allentown Art Museum Munds Park, AZ Gatineau, Quebec Museo Guggenheim — Allentown, PA Bilbao Fine Arts Museum of Canadian Museum of Nature Bilbao, Viz Caya Anacostia Community San Francisco Ottawa, Ontario Museum San Francisco, CA Washington, DC Facility Management UNITED KINGDOM Freer Gallery of Art and Services LTD Architrve PC Architects Arthur M. Sackler Gallery Calgary, Alberta Washington, DC Washington, DC British Library Groupe Smi-Enerpro London, England Arkansas Art Center Friends of Iolani Palace Longueuil, Quebec Little Rock, AR Honolulu, HI British Museum Library and Archives Canada London, England Art Institute of Chicago Glide Foundation Gatineau, Quebec Chicago, IL San Francisco, CA Camfil Limited Lundholm Associates Haslingden, Lancashire Arts and Industries Building Hagley Museum & Library Architects Washington, DC Wilmington, DE Creative Consulting Toronto, Ontario Partnership LLP London, England 46 PAPYRUS SUMMER–FALL 2010
  • 49.
    Harley-Davidson Museum Museum of Contemporary National Museum of the Smithsonian Institution Milwaukee, WI Art — Chicago United States Army Washington, DC Chicago, IL Fort Belvoir, VA Harvard Art Museum Smithsonian Institution Cambridge, MA Museum of Fine Arts — National Portrait Gallery Building, The Castle Boston Washington, DC Washington, DC Henry Ford Museum Boston, MA Dearborn, MI National Postal Museum Smithsonian National Air Museum of Fine Arts — Washington, DC and Space Museum Henry Morrison Flagler Houston Suitland, MD Museum Houston, TX National Zoological Park Palm Beach, FL Washington, DC Solomon R. Guggenheim National Air and Space Museum High Museum of Art Museum Neue Galerie New York, NY Atlanta, GA New York, NY Washington, DC Stanford University Green Hirshhorn Museum and National Air and Space Newark Museum Library Sculpture Garden Newark, NJ Museum — Stanford, CA Washington, DC Udvar-Hazy Center Norton Museum of Art Chantilly, VA U.S. Holocaust Museum Isabella Stewart Gardner West Palm Beach, FL Washington, DC Museum National Gallery of Art — Boston, MA Office of Facilities The Whiting-Turner Washington Engineering & Operations Washington, DC Contracrting Company J. Paul Getty Trust Washington, DC Baltimore, MD Los Angeles, CA National Museum of African Peabody Essex Museum American History and Winterthur Museum, Garden The Jewish Museum Salem, MA Culture and Library New York, NY Philadelphia Museum of Art Winterthur, DE Washington, DC Landmark Facilities Group, Philadelphia, PA National Museum of African Yale University Art Gallery Inc. New Haven, CT Norwalk, CT Art Questions and Solutions Washington, DC Engineering, Inc. Library of Congress Chaska, MN Washington, DC National Museum of This list reflects American History Renwick Gallery Lighting Services Inc. Washington, DC Washington, DC membership Stony Point, NY dues paid as of National Museum of Marine Rutherford & Chekene July 15, 2010 Los Angeles County Museum Corps San Francisco, CA of Art Although we do our best Triangle, VA San Francisco Maritime Los Angeles, CA to ensure that our National Museum of Natural National Historic Park Directory information is Mariner’s Museum History San Francisco, CA as up-to-date as possible, Newport News, VA Washington, DC San Francisco Museum of errors and omissions can McGuire Engineers National Museum of the Modern Art always occur. If you Chicago, IL American Indian San Francisco, CA would like to make any Washington, DC changes to your Milwaukee Public Museum Smithsonian American Art Milwaukee, WI Museum listing, please contact National Museum of the Larry Bannister at American Indian — Washington, DC Morikami Museum and bannister@mpm.edu Japanese Gardens George Gustav Heye Center Delray Beach, FL New York, NY Become a Member of IAMFA For more information on becoming a member of the International Association of Museum Facility Administrators, please visit WWW.IAMFA.ORG PAPYRUS SUMMER–FALL 2010 47
  • 50.
    Puzzle Page 48 PAPYRUS SUMMER–FALL 2010
