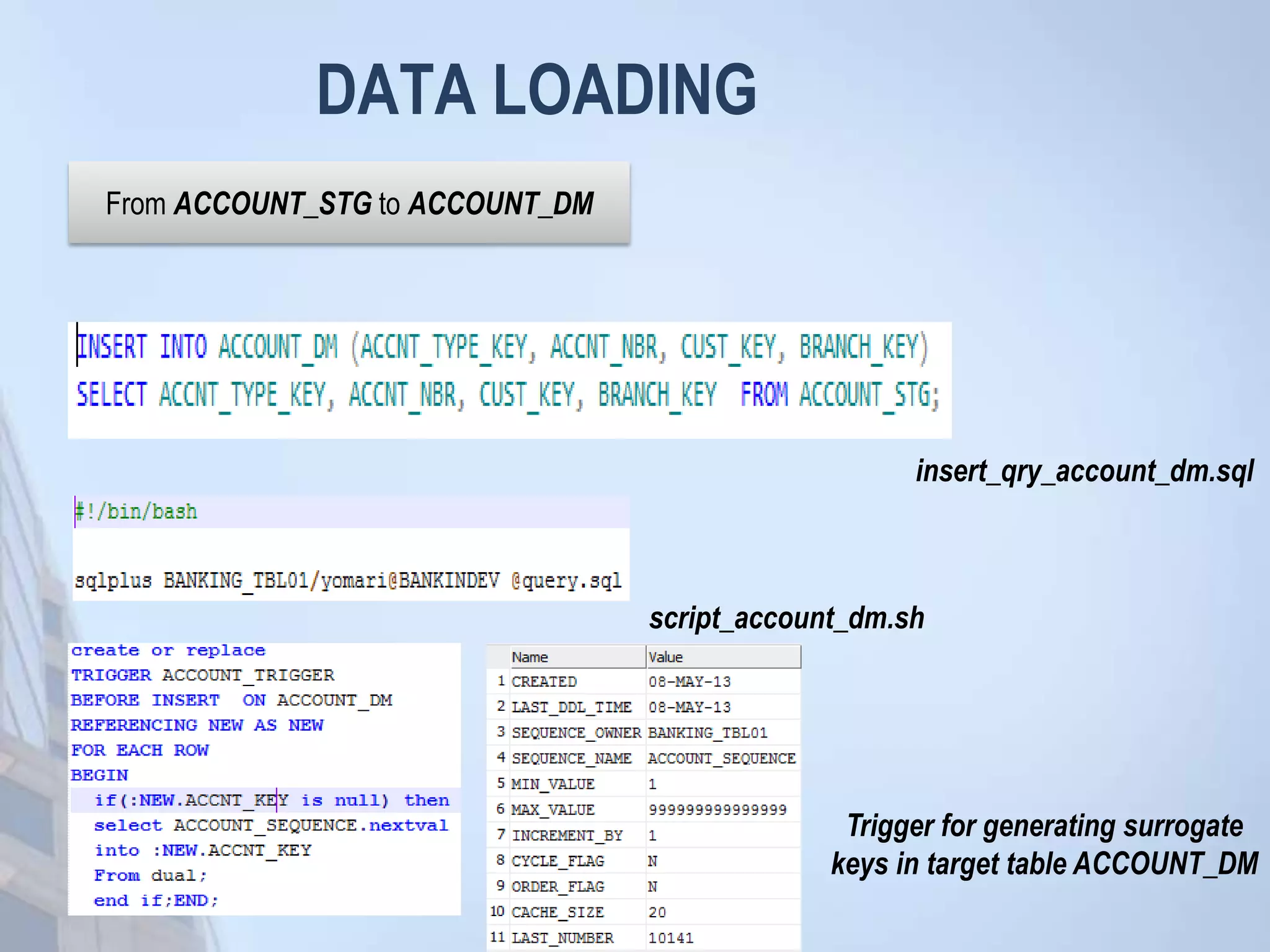

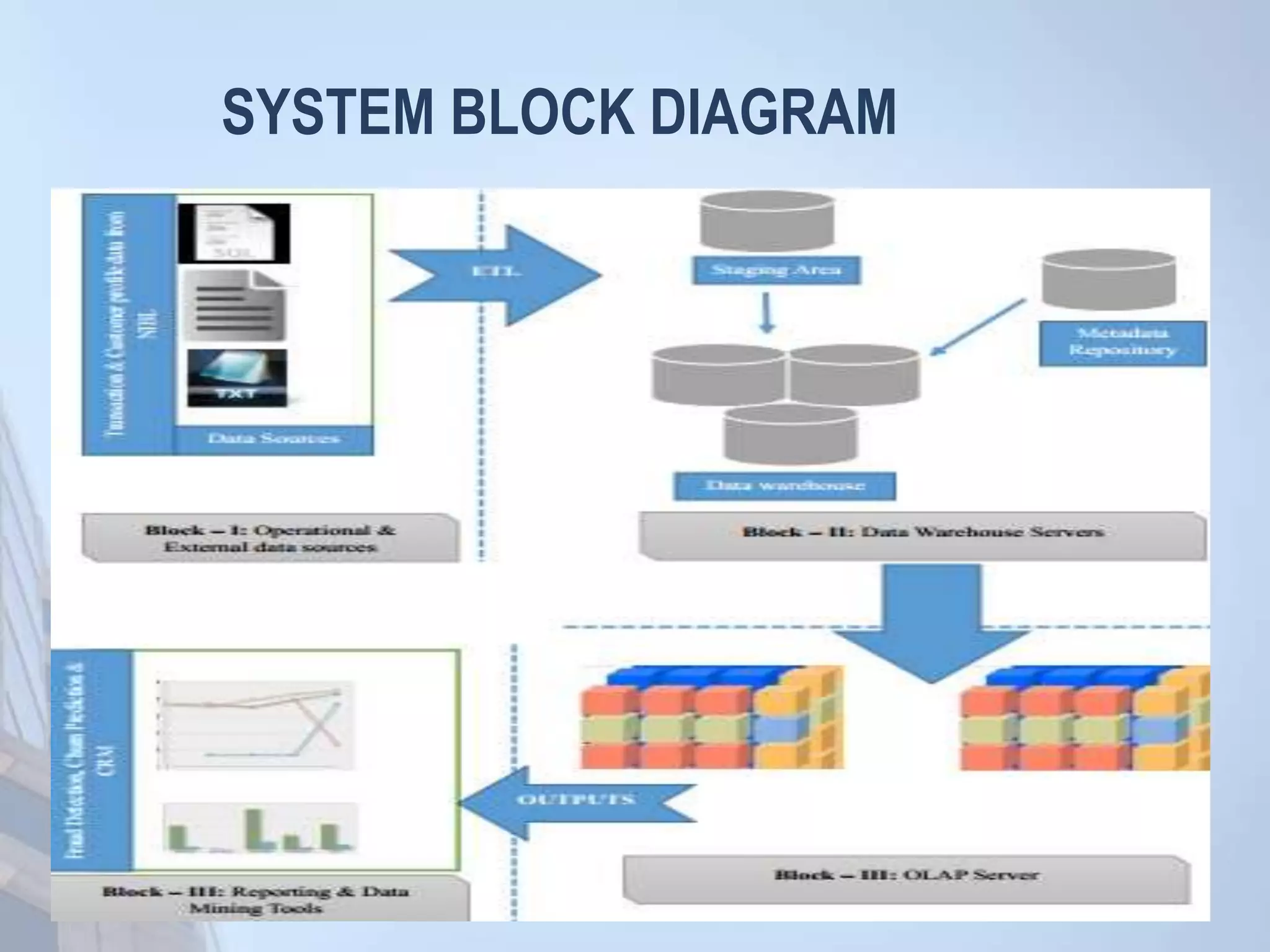

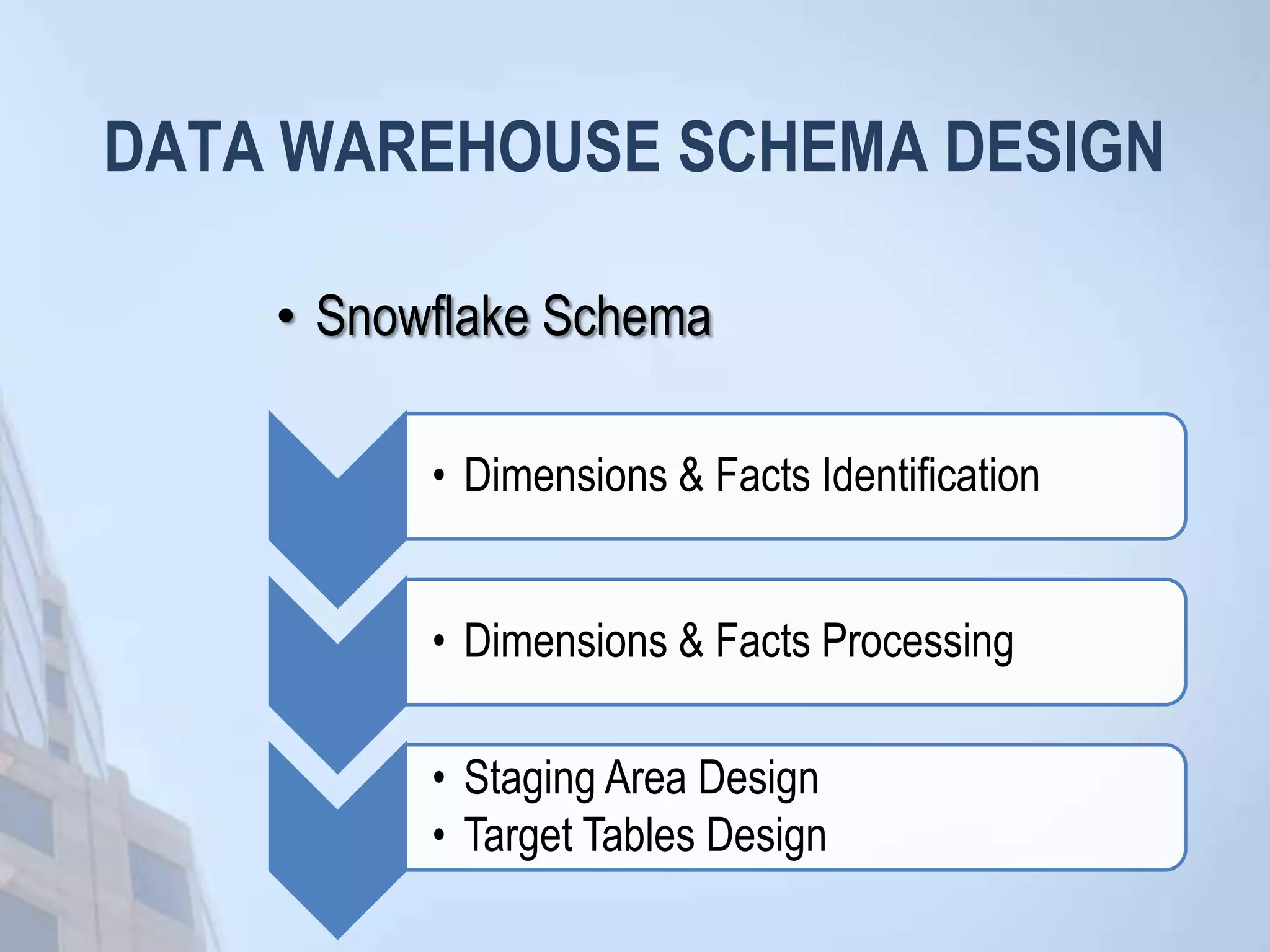

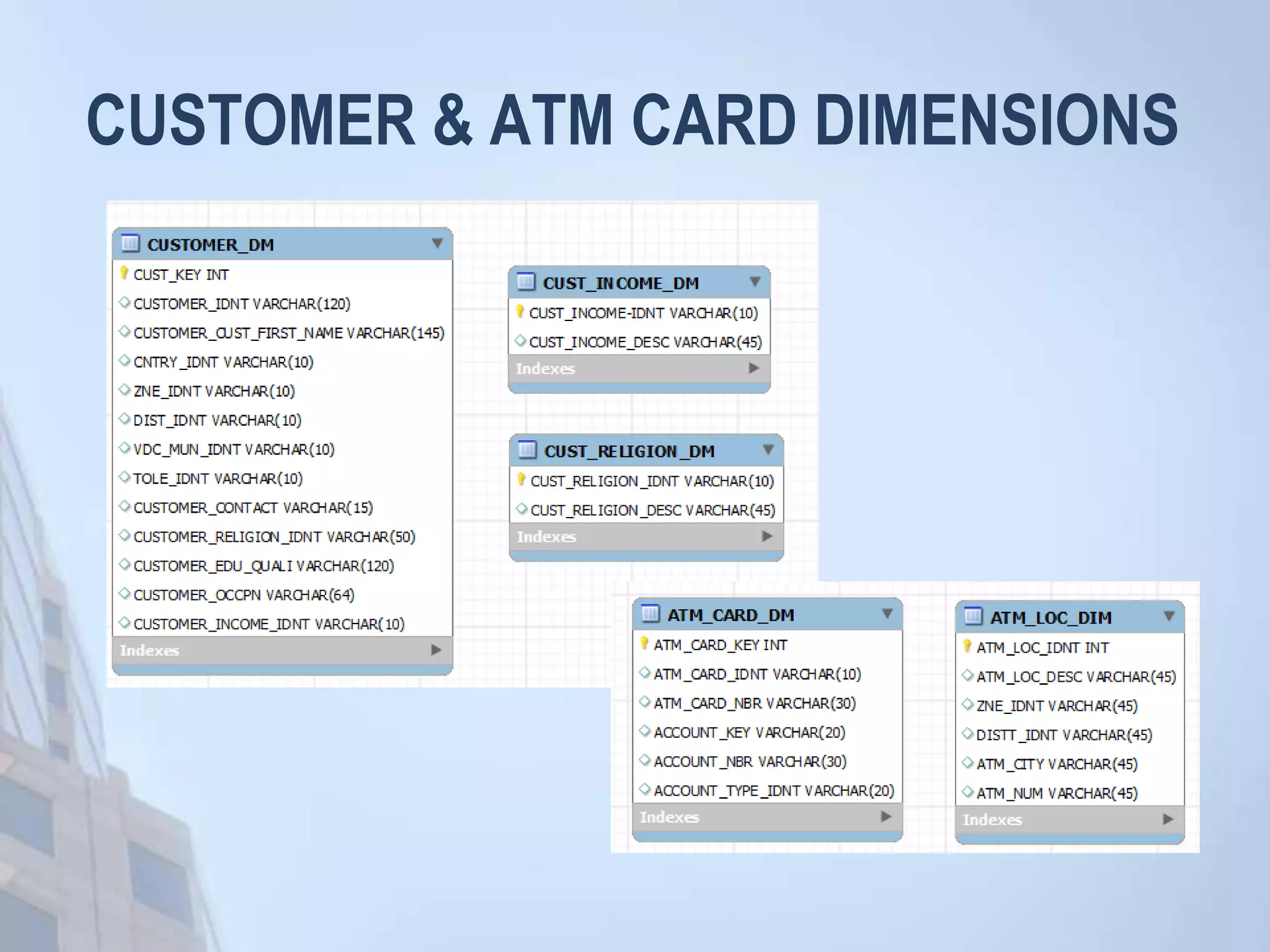

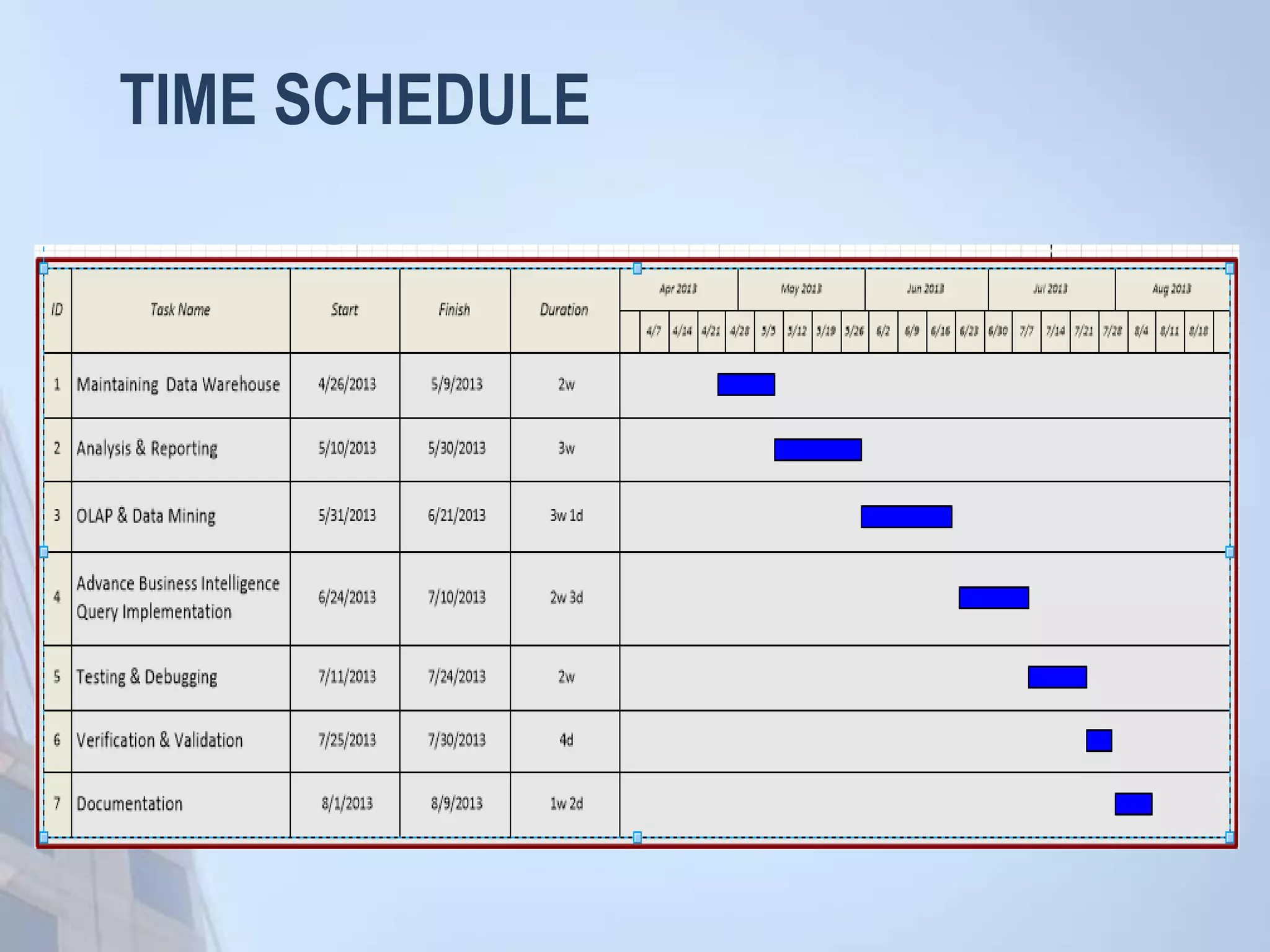

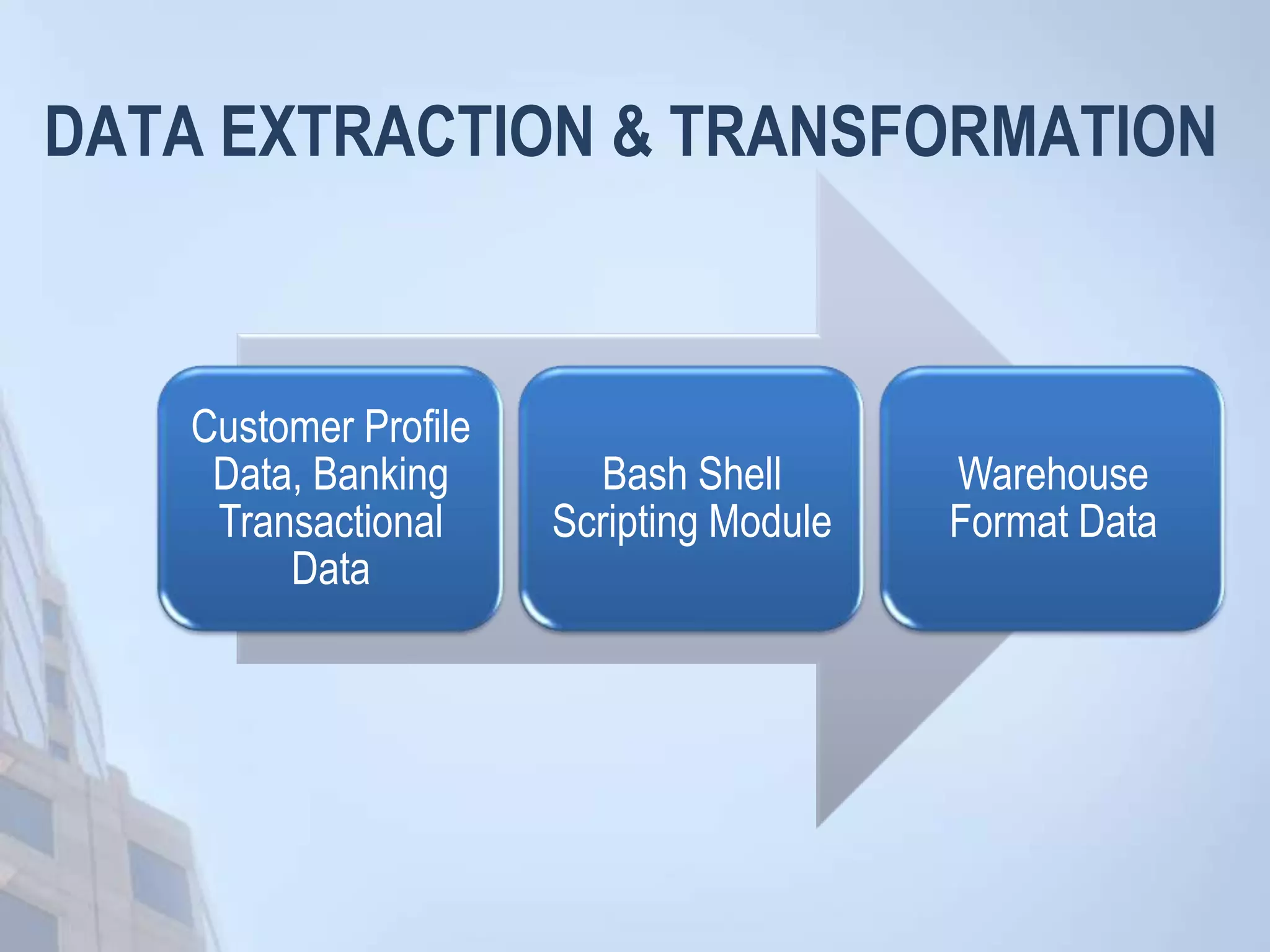

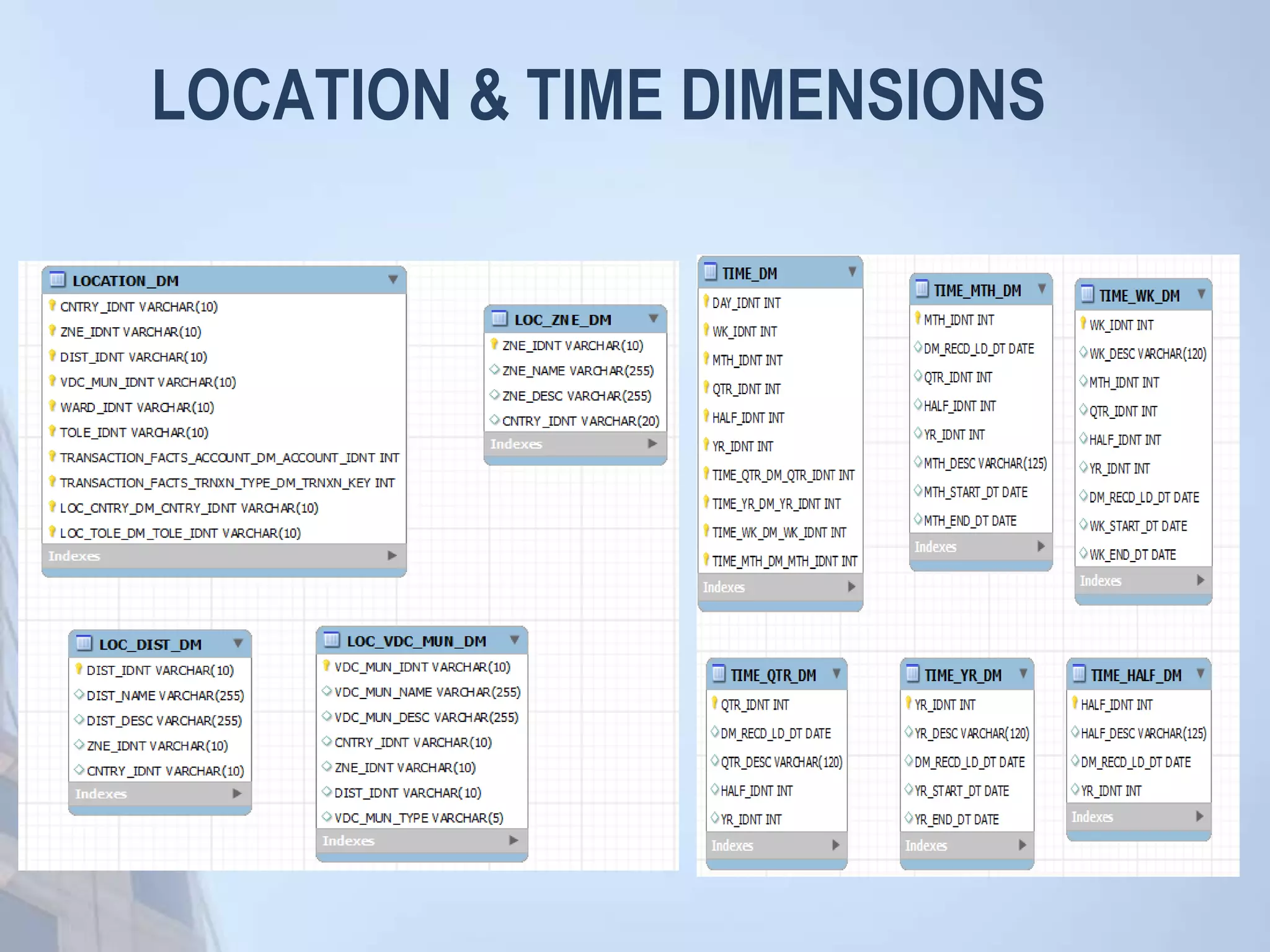

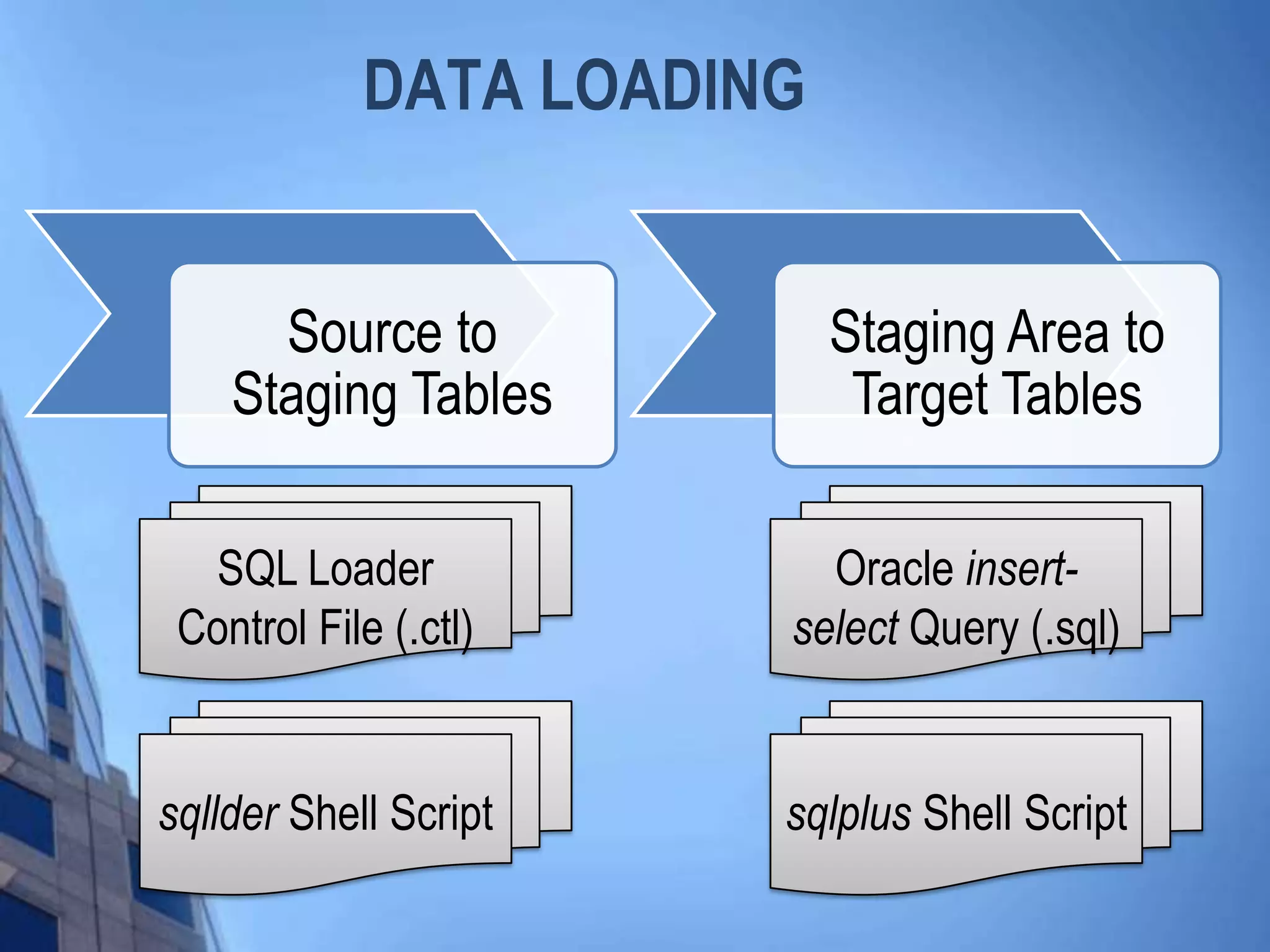

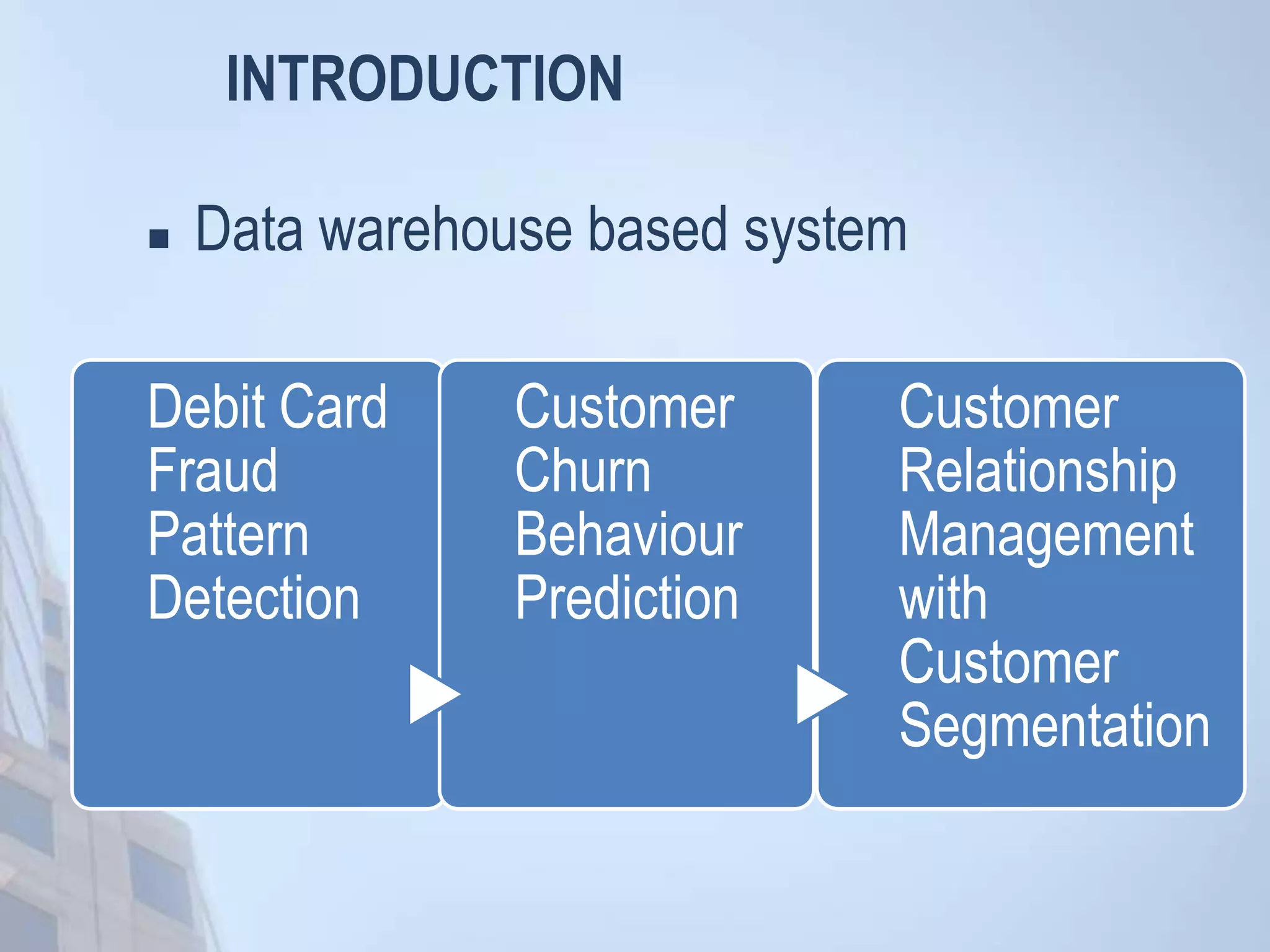

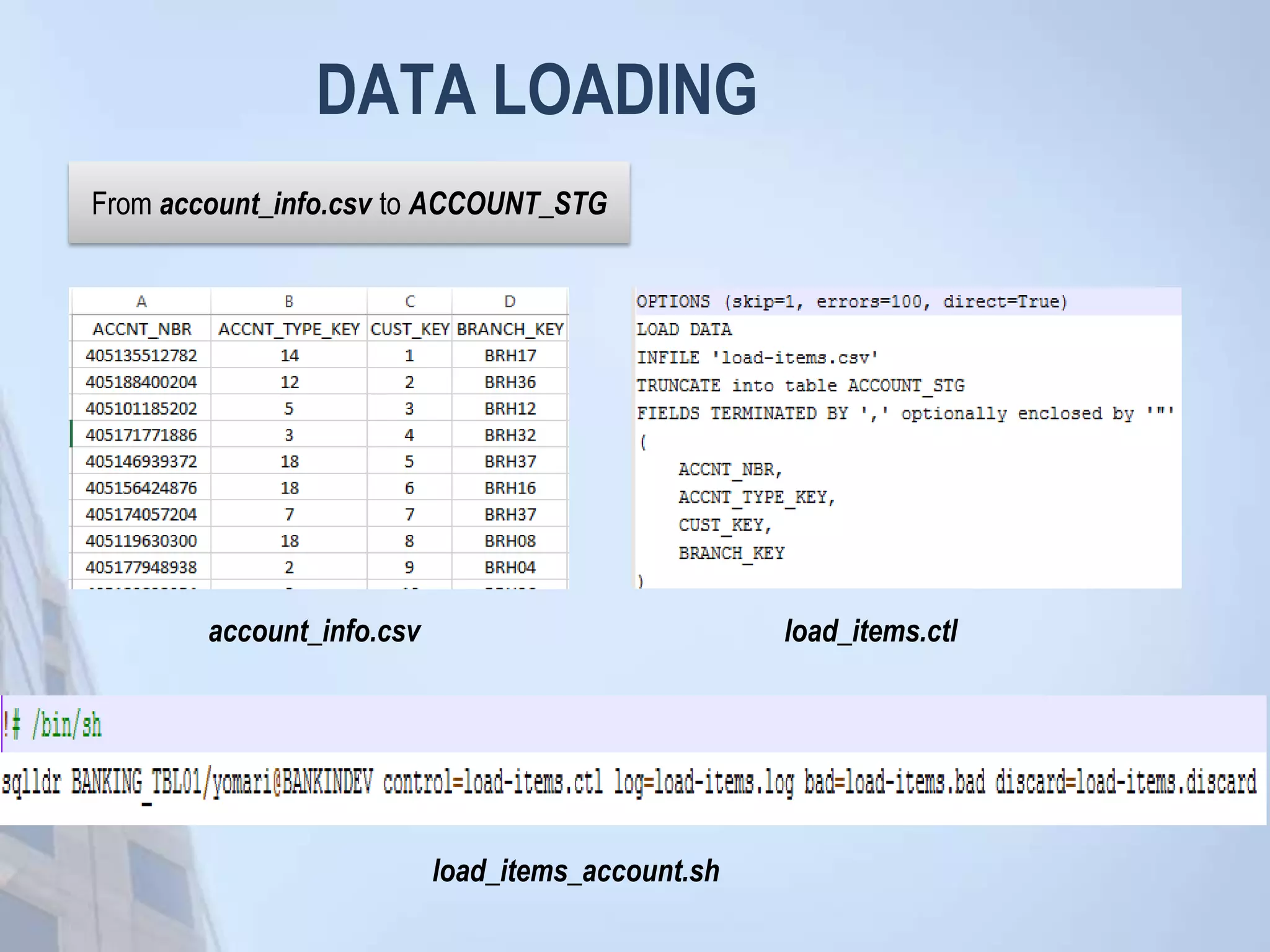

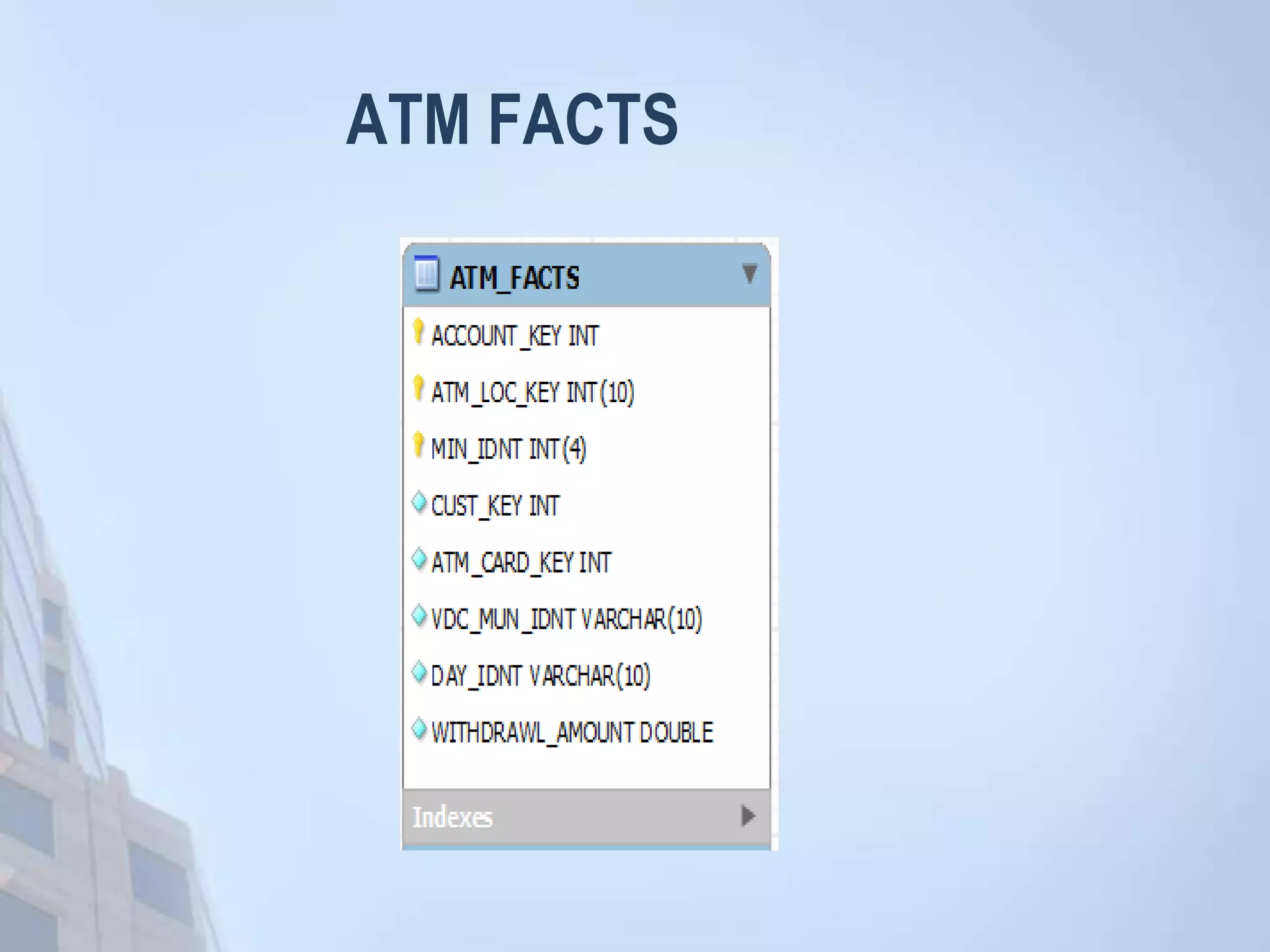

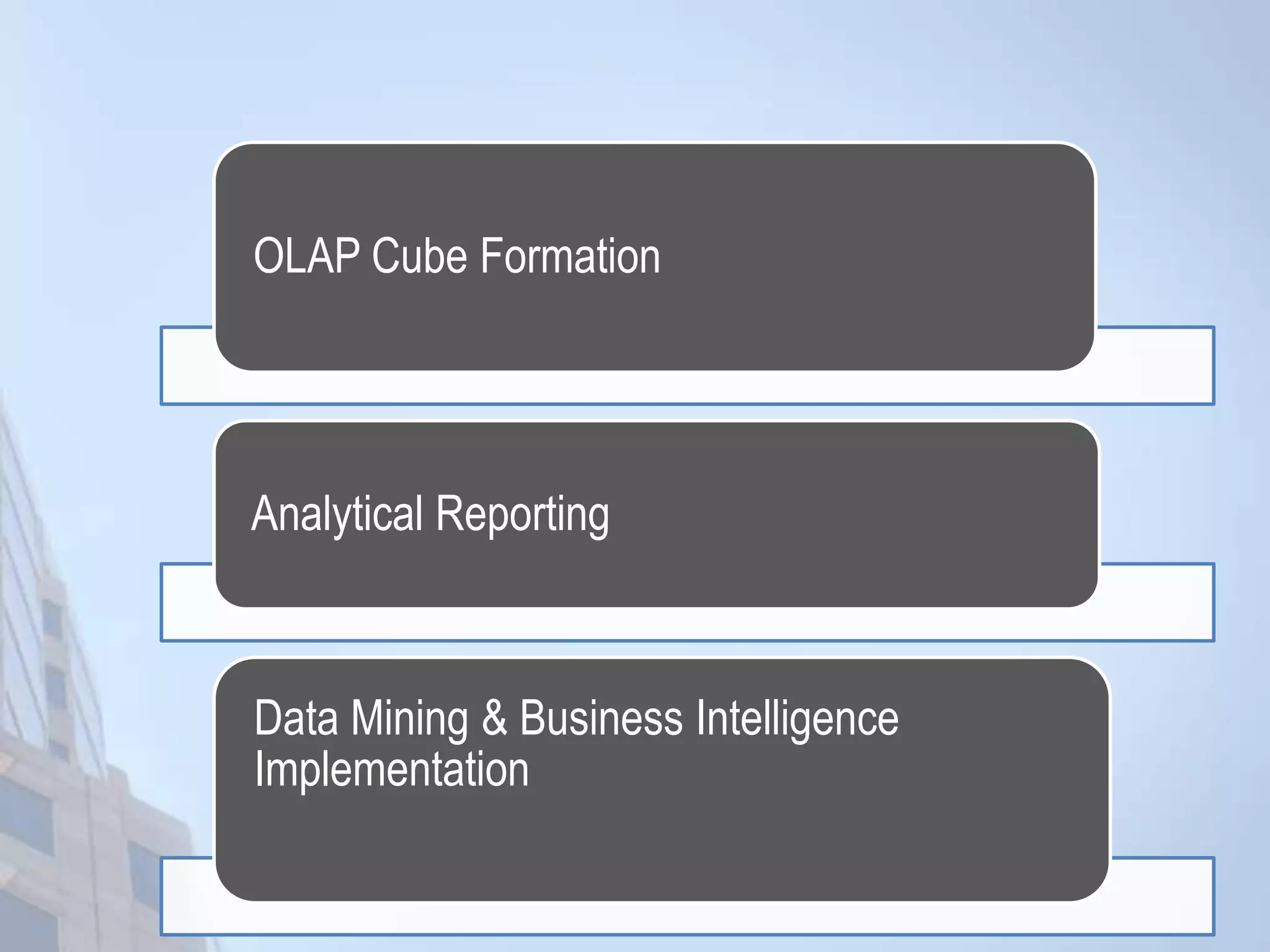

This document outlines a project to build a data warehouse for analyzing banking transactions. It includes an introduction, system block diagram, data collection, extraction and transformation, data warehouse schema design, data loading, and milestones. The project aims to enable debit card fraud detection, customer churn prediction, and customer relationship management through customer segmentation. The document describes extracting customer and transaction data, designing dimensions and facts, loading data into staging and target tables, and forming dimensions for customer, ATM card, location and time. It concludes with next steps of OLAP cube formation, analytical reporting, data mining implementation and a time schedule.
