MANAGING THE
INNOVATION PORTFOLIO
AND PROJECTS
Cliff Wachtel
Project Management Lecture Presentation

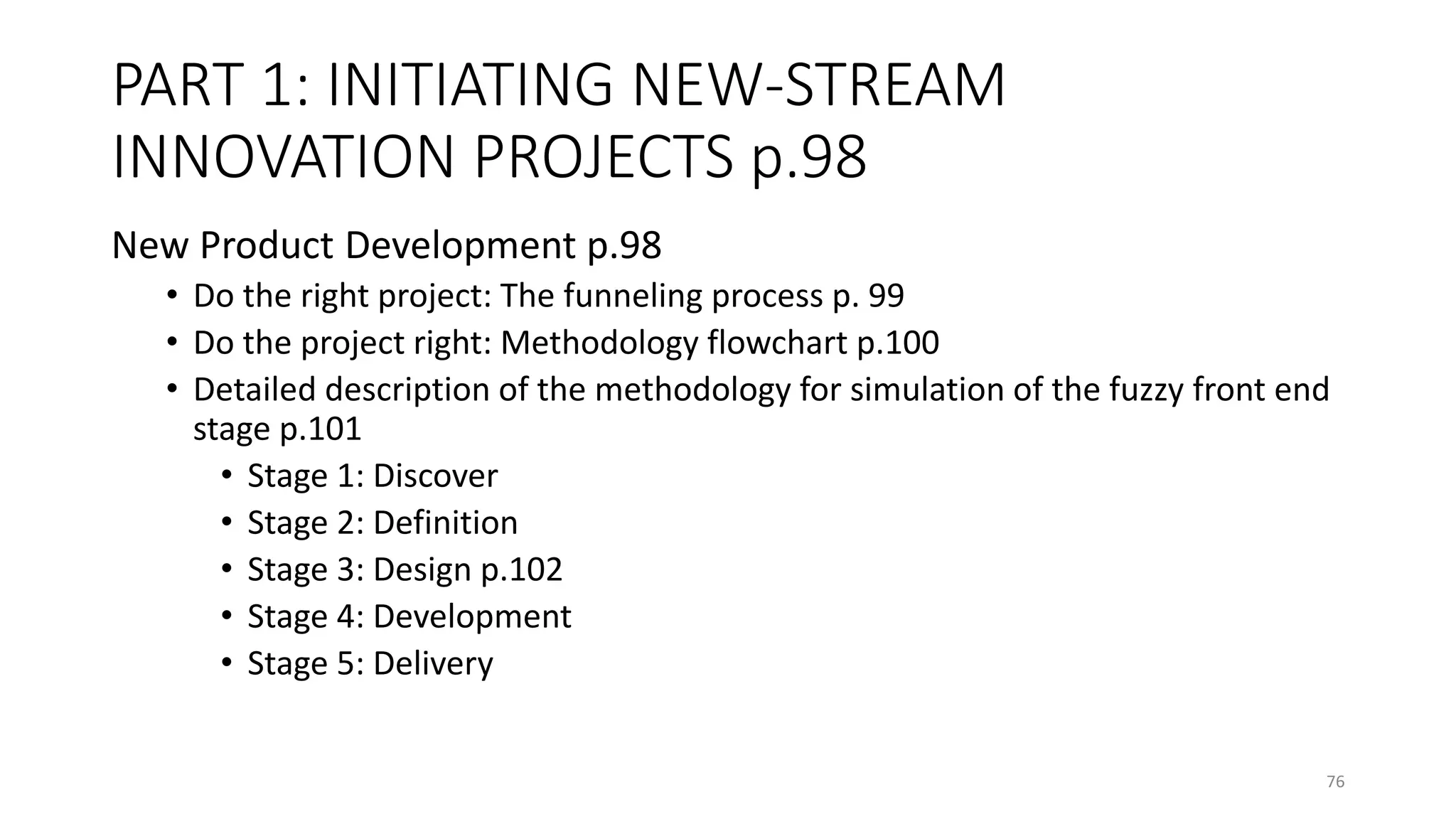

1

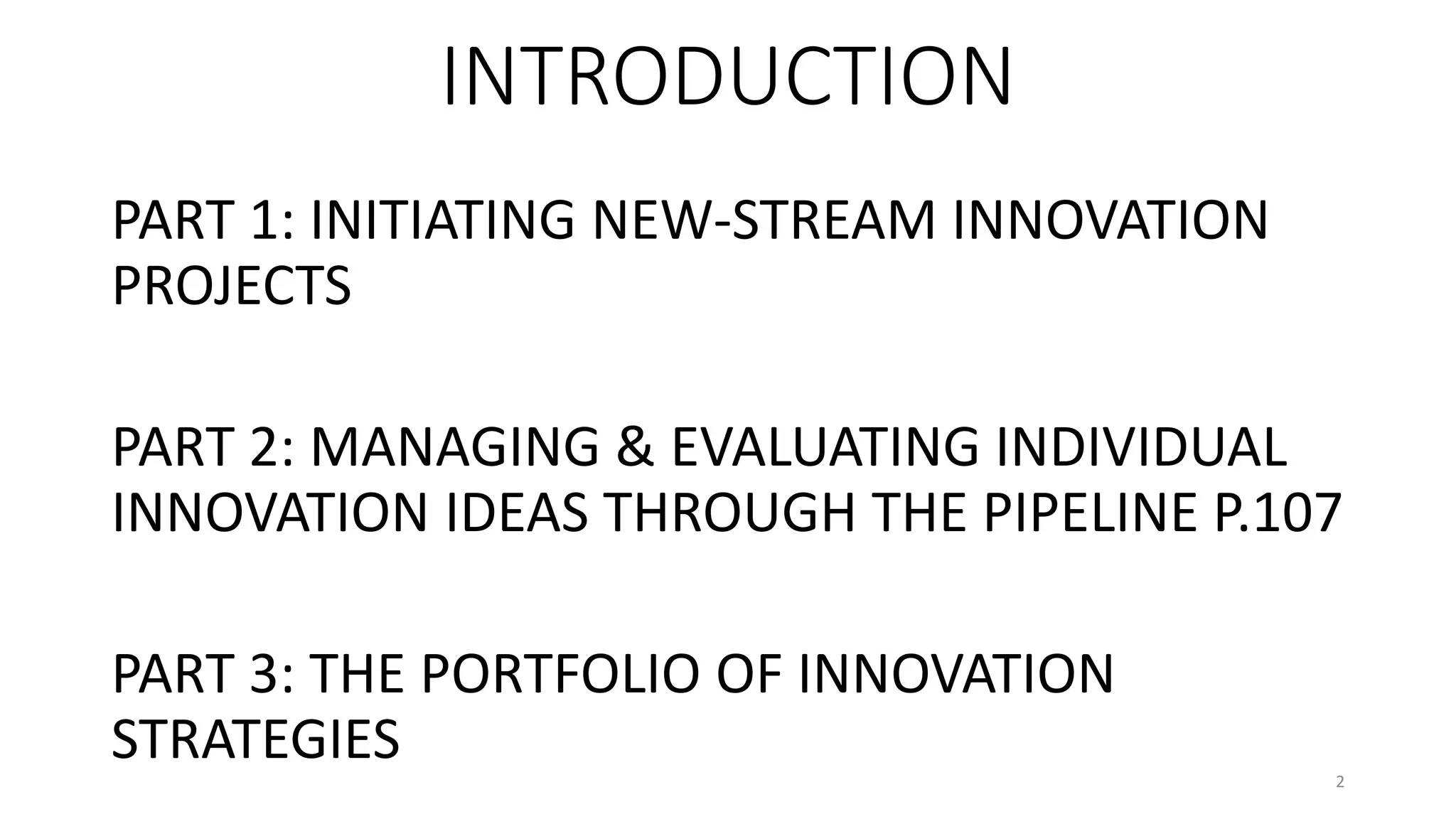

INTRODUCTION
PART 1: INITIATING NEW-STREAM INNOVATION
PROJECTS
PART 2: MANAGING & EVALUATING INDIVIDUAL
INNOVATION IDEAS THROUGH THE PIPELINE P.107
PART 3: THE PORTFOLIO OF INNOVATION
STRATEGIES 2
PART 1: INITIATING NEW-STREAM INNOVATION
PROJECTS
New Product Development (henceforth “NPD”) -3 parts p.98
• Do the right project: The funneling process p. 99
• Do the project right: Methodology flowchart p. 100
• Detailed description of the methodology for simulation
of the fuzzy front end stage p.101
3
PART 2: MANAGING AND EVALUATING INDIVIDUAL
INNOVATION IDEAS THROUGH THE PIPELINE P.107
Part 2A: Use Project Management Philosophy, Tools,
And Techniques p. 108
Part 2B: 8 Tests To Identify “High Potential” Ideas For
Innovation Investment p109
4

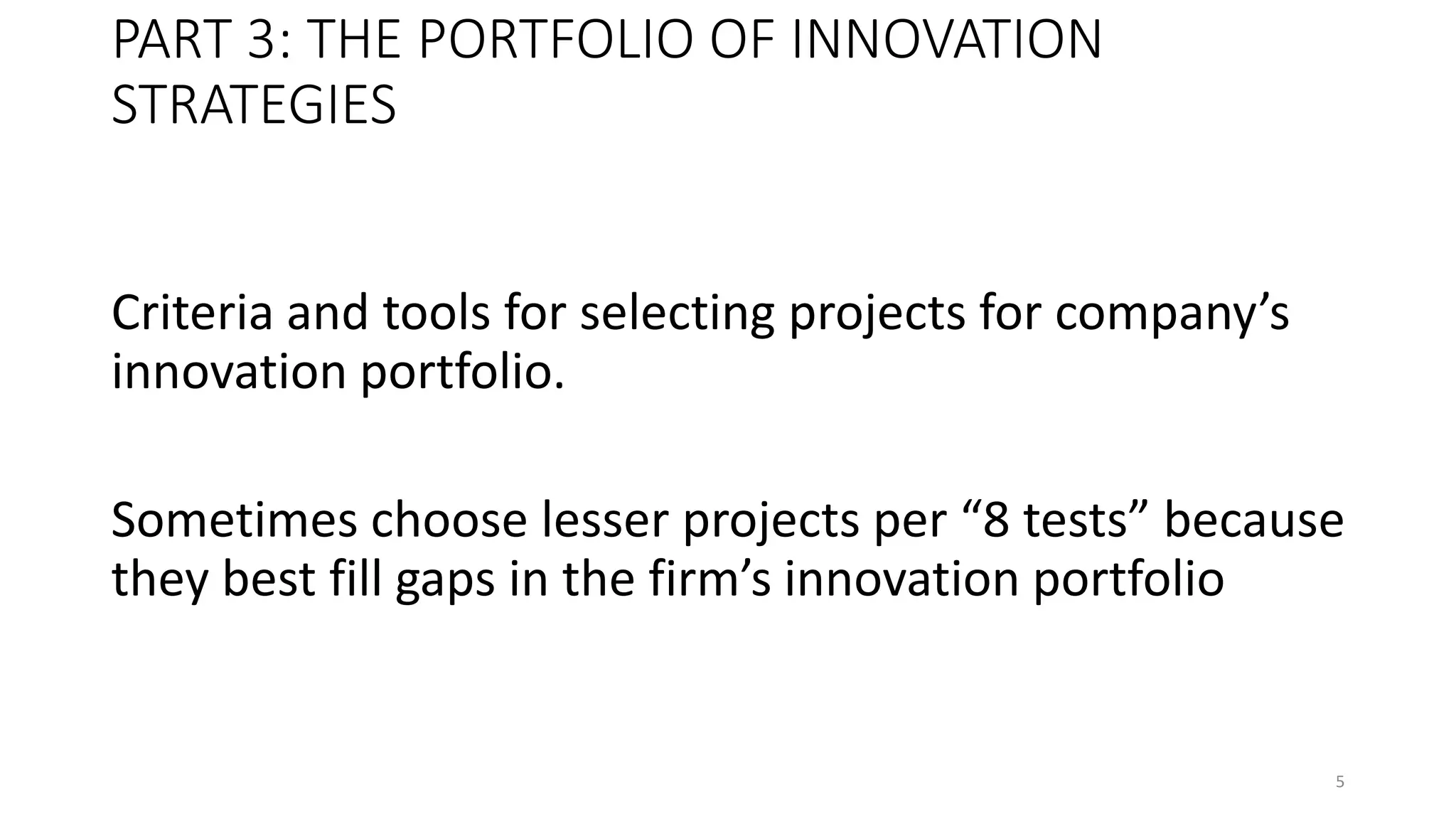

PART 3: THE PORTFOLIO OF INNOVATION
STRATEGIES
Criteria and tools for selecting projects for company’s
innovation portfolio.
Sometimes choose lesser projects per “8 tests” because
they best fill gaps in the firm’s innovation portfolio
5

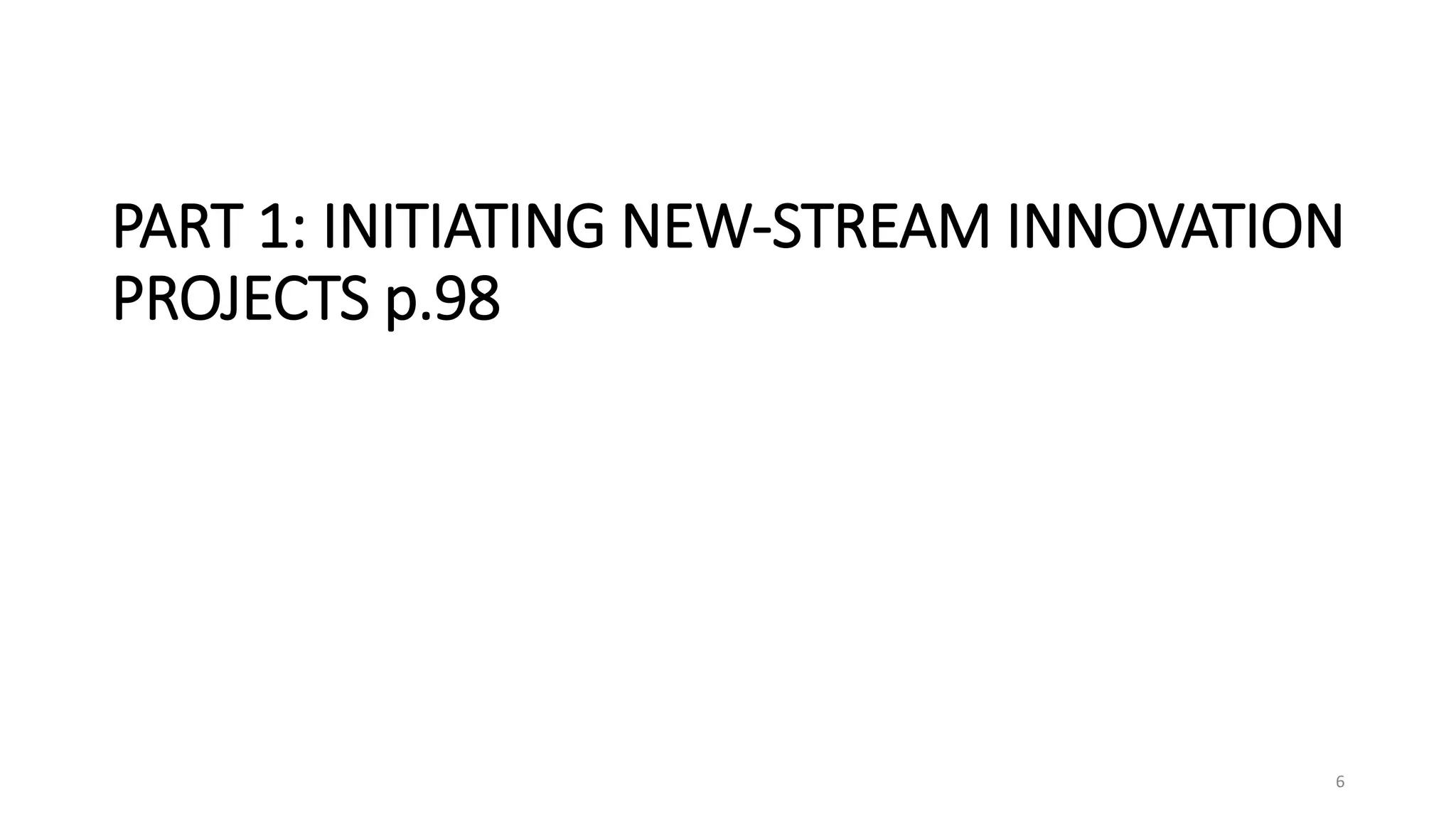

PART 1: INITIATING NEW-STREAM INNOVATION
PROJECTS p.98
6
7

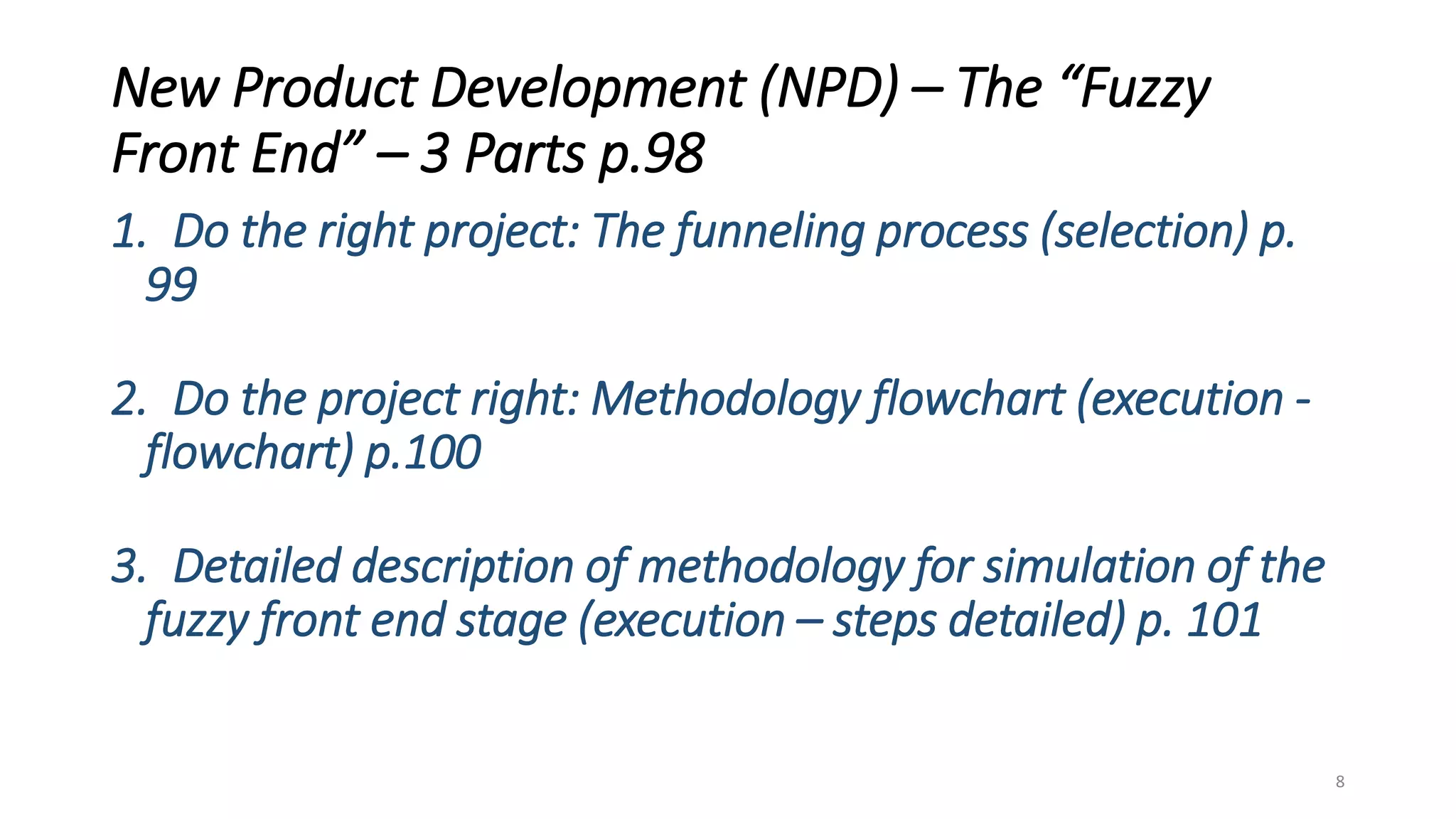

New Product Development (NPD) – The “Fuzzy
Front End” – 3 Parts p.98
1. Do the right project: The funneling process (selection) p.
99
2. Do the project right: Methodology flowchart (execution -
flowchart) p.100
3. Detailed description of methodology for simulation of the
fuzzy front end stage (execution – steps detailed) p. 101
8

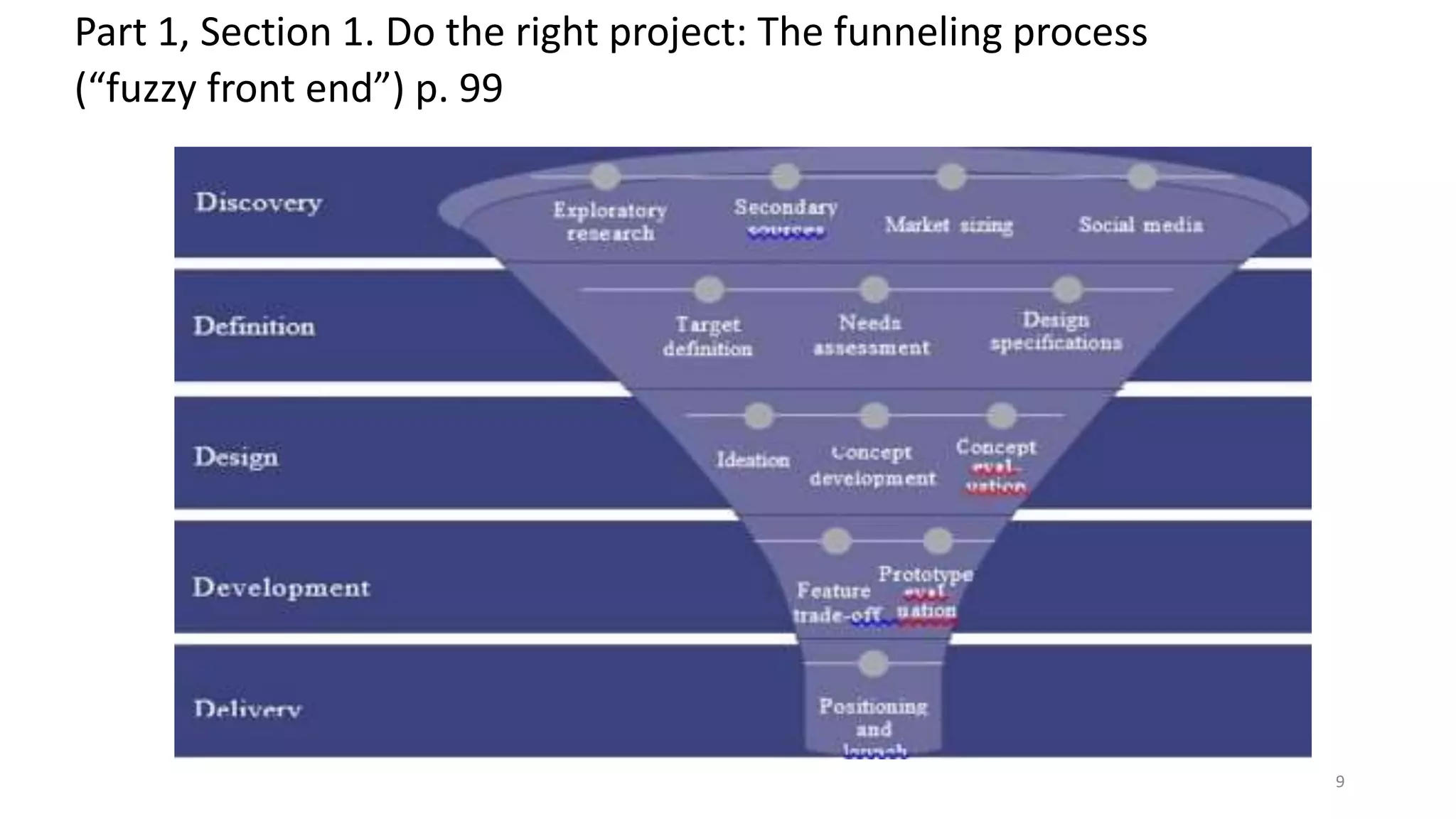

Part 1, Section 1. Do the right project: The funneling process
(“fuzzy front end”) p. 99
Source: Katz, 2011,available at http://www.innovationexcellence.com/blog/2011/11/29/
rethinking-the-product-development-funnel
9

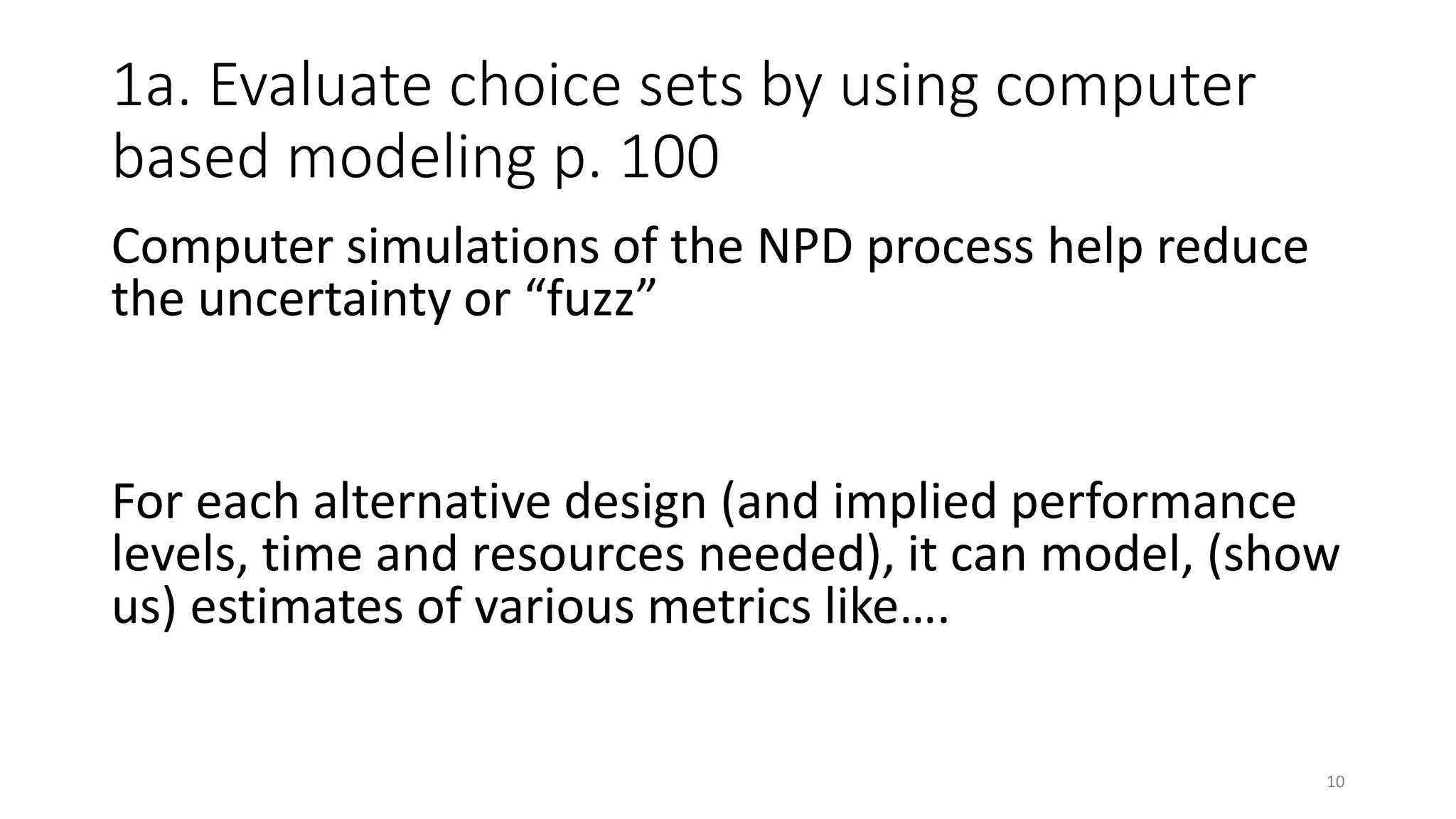

1a. Evaluate choice sets by using computer
based modeling p. 100
Computer simulations of the NPD process help reduce
the uncertainty or “fuzz”
For each alternative design (and implied performance
levels, time and resources needed), it can model, (show
us) estimates of various metrics like….
10

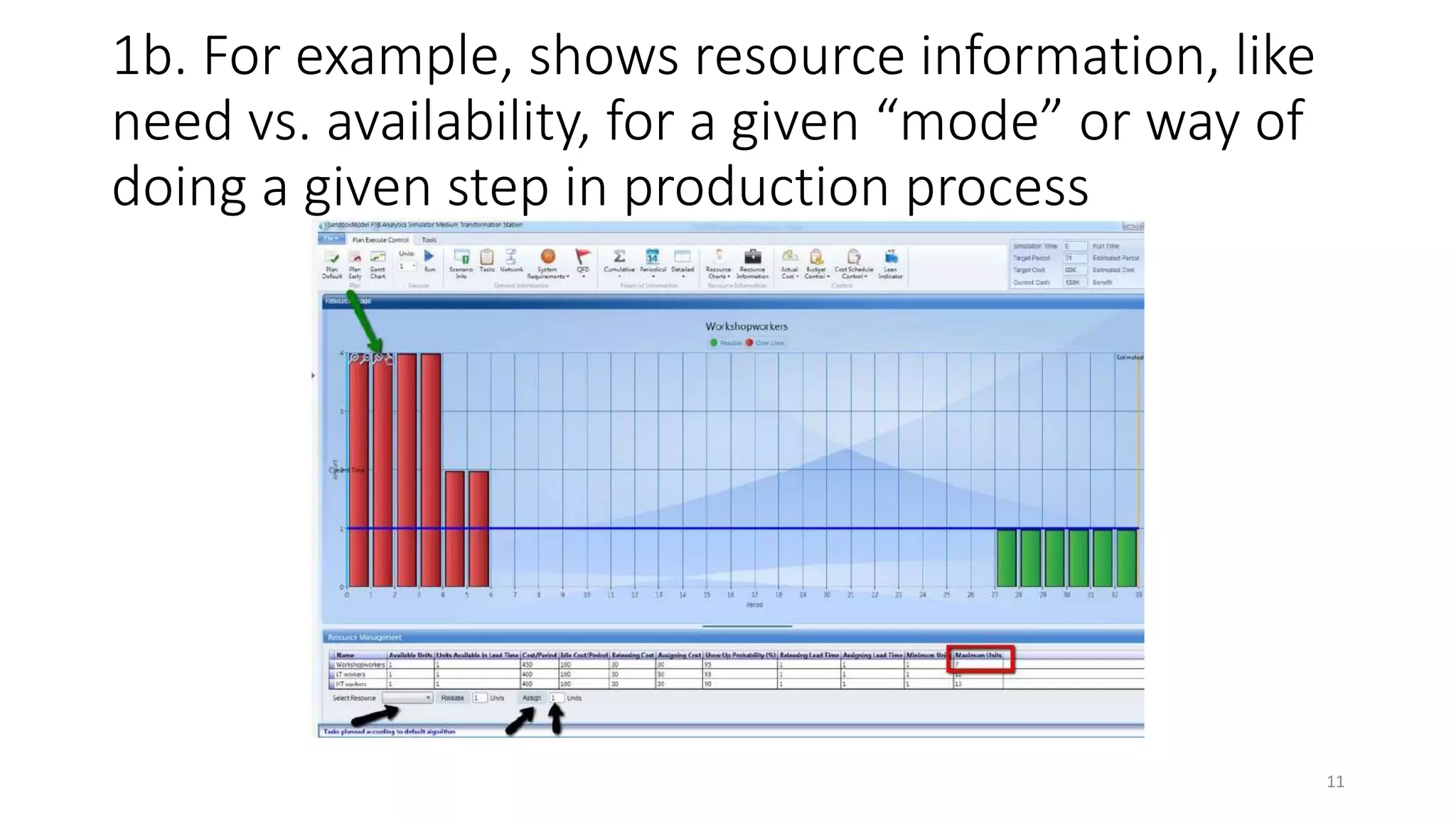

1b. For example, shows resource information, like
need vs. availability, for a given “mode” or way of
doing a given step in production process
11

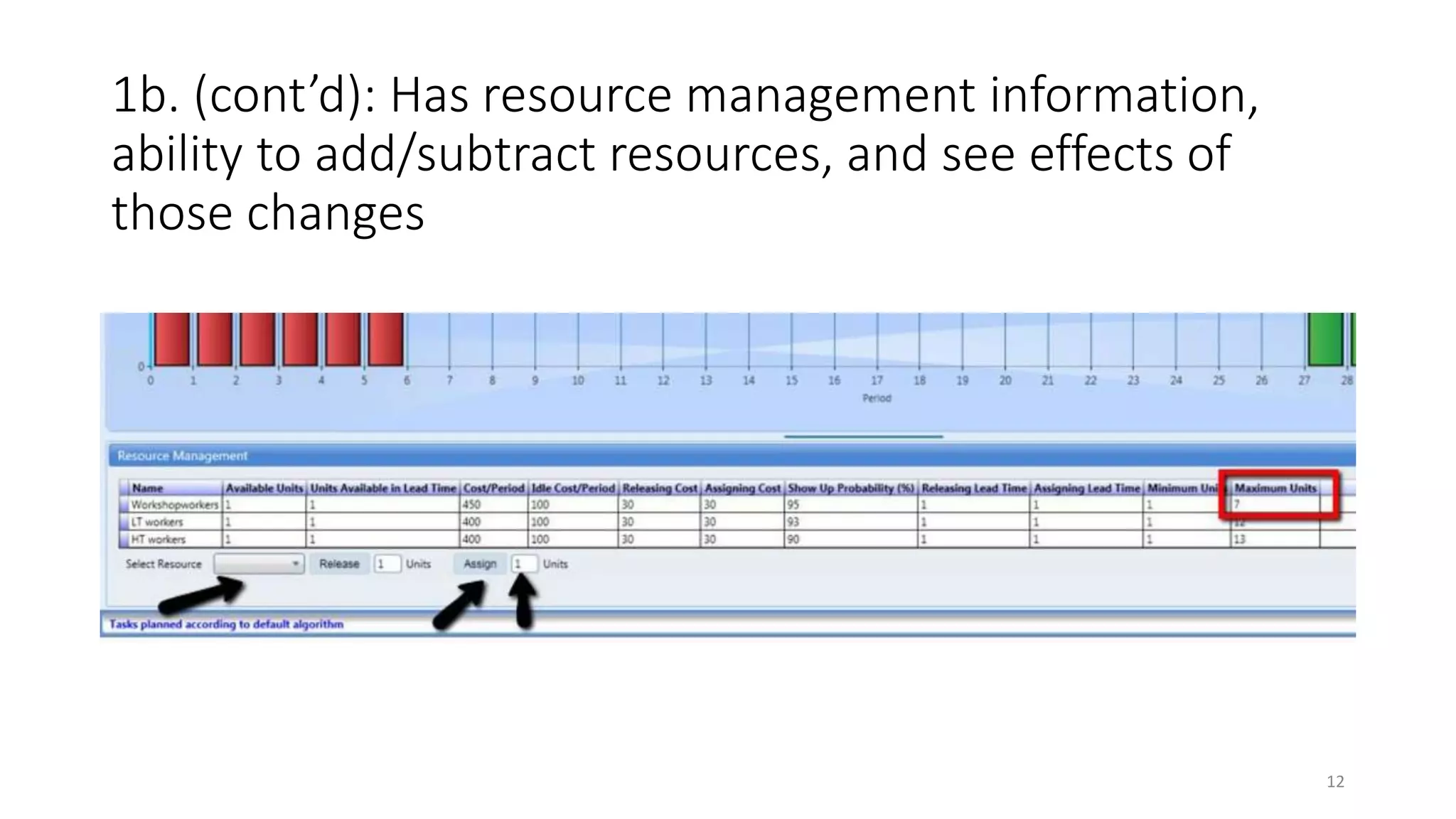

1b. (cont’d): Has resource management information,
ability to add/subtract resources, and see effects of
those changes
12

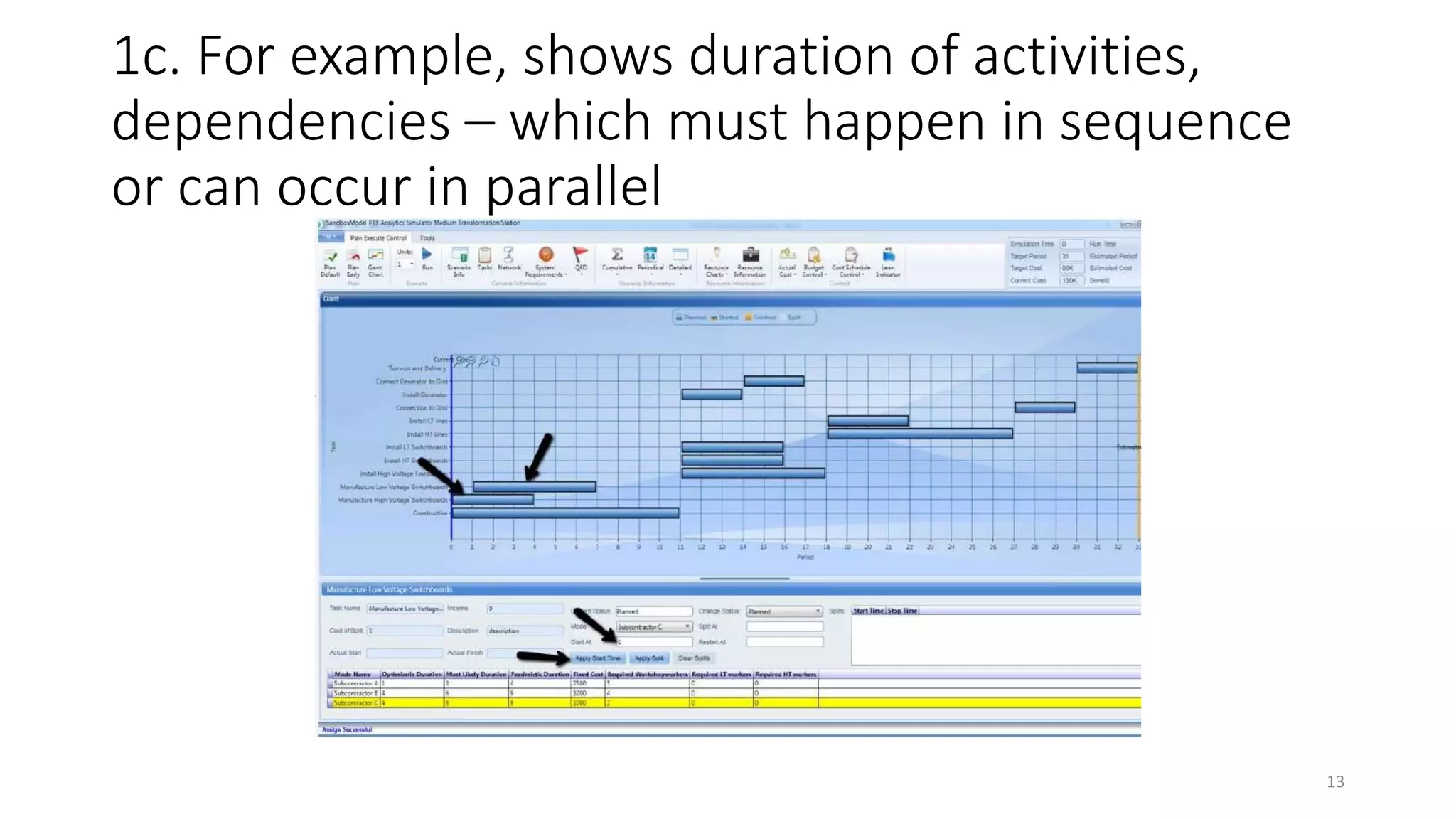

1c. For example, shows duration of activities,
dependencies – which must happen in sequence
or can occur in parallel
13

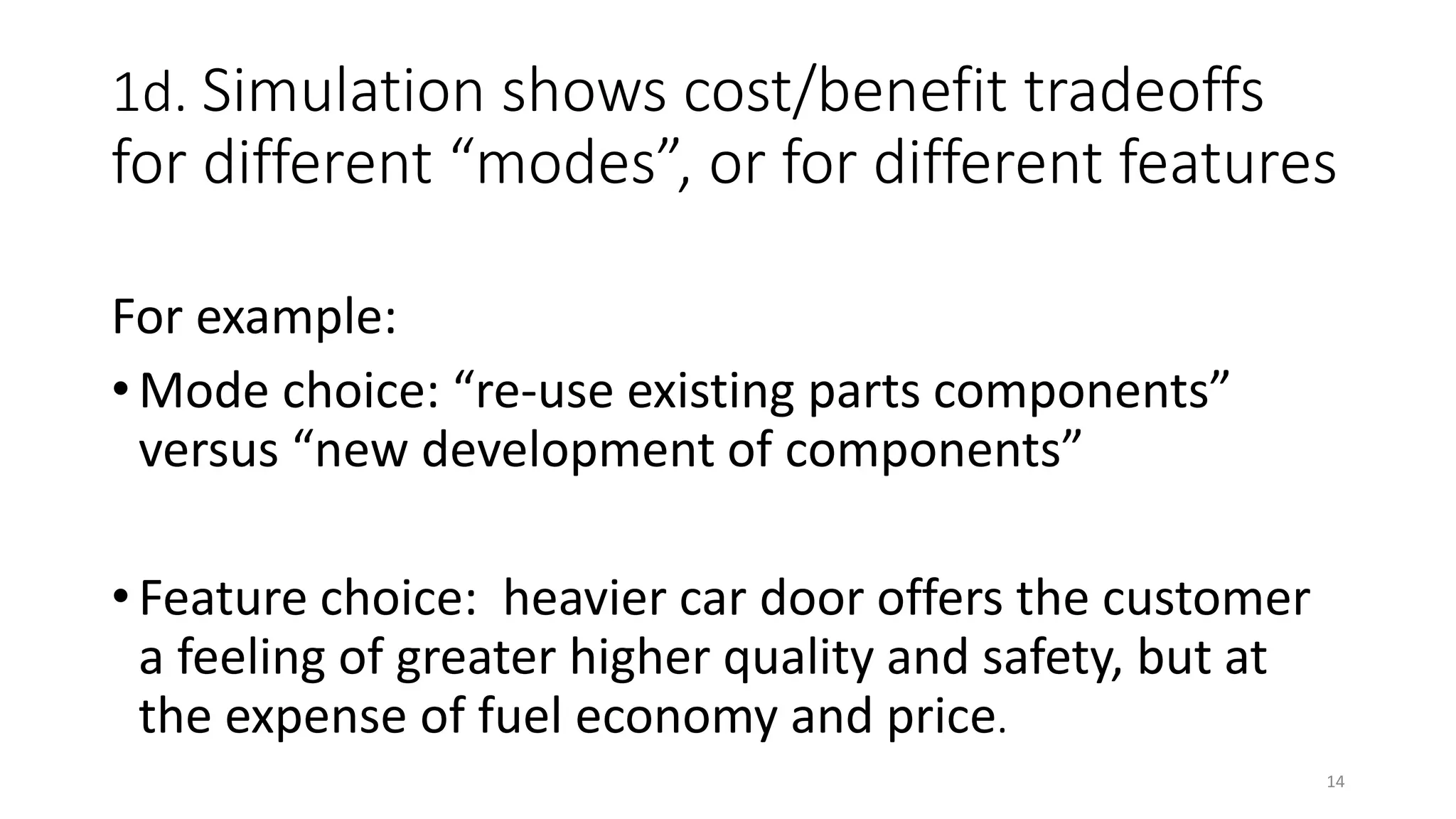

1d. Simulation shows cost/benefit tradeoffs
for different “modes”, or for different features
For example:
• Mode choice: “re-use existing parts components”
versus “new development of components”
• Feature choice: heavier car door offers the customer
a feeling of greater higher quality and safety, but at
the expense of fuel economy and price.
14

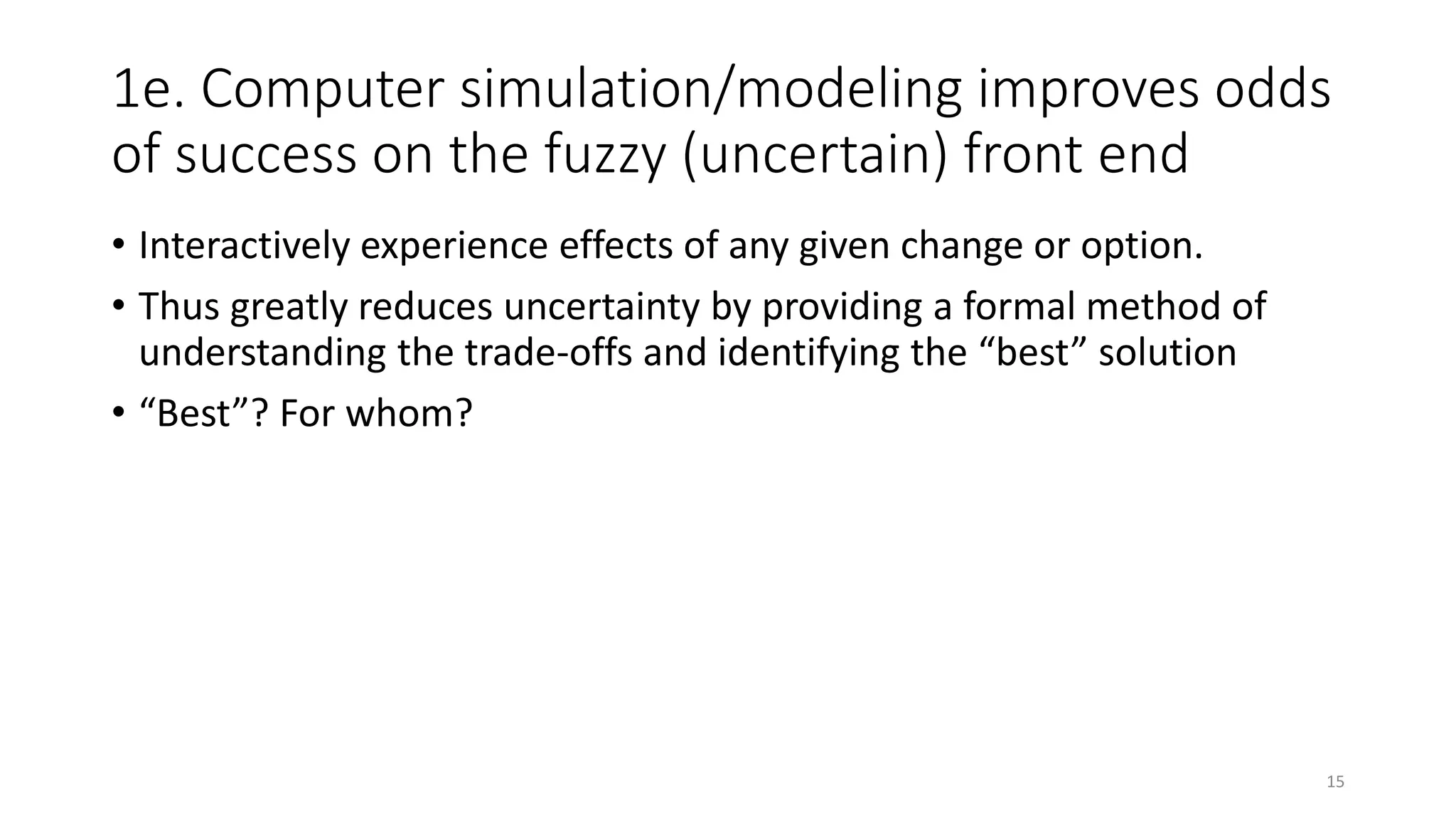

1e. Computer simulation/modeling improves odds
of success on the fuzzy (uncertain) front end
• Interactively experience effects of any given change or option.
• Thus greatly reduces uncertainty by providing a formal method of
understanding the trade-offs and identifying the “best” solution
• “Best”? For whom?
15
Part 1, Section 2. Do the project right: Methodology flowchart p. 100
16

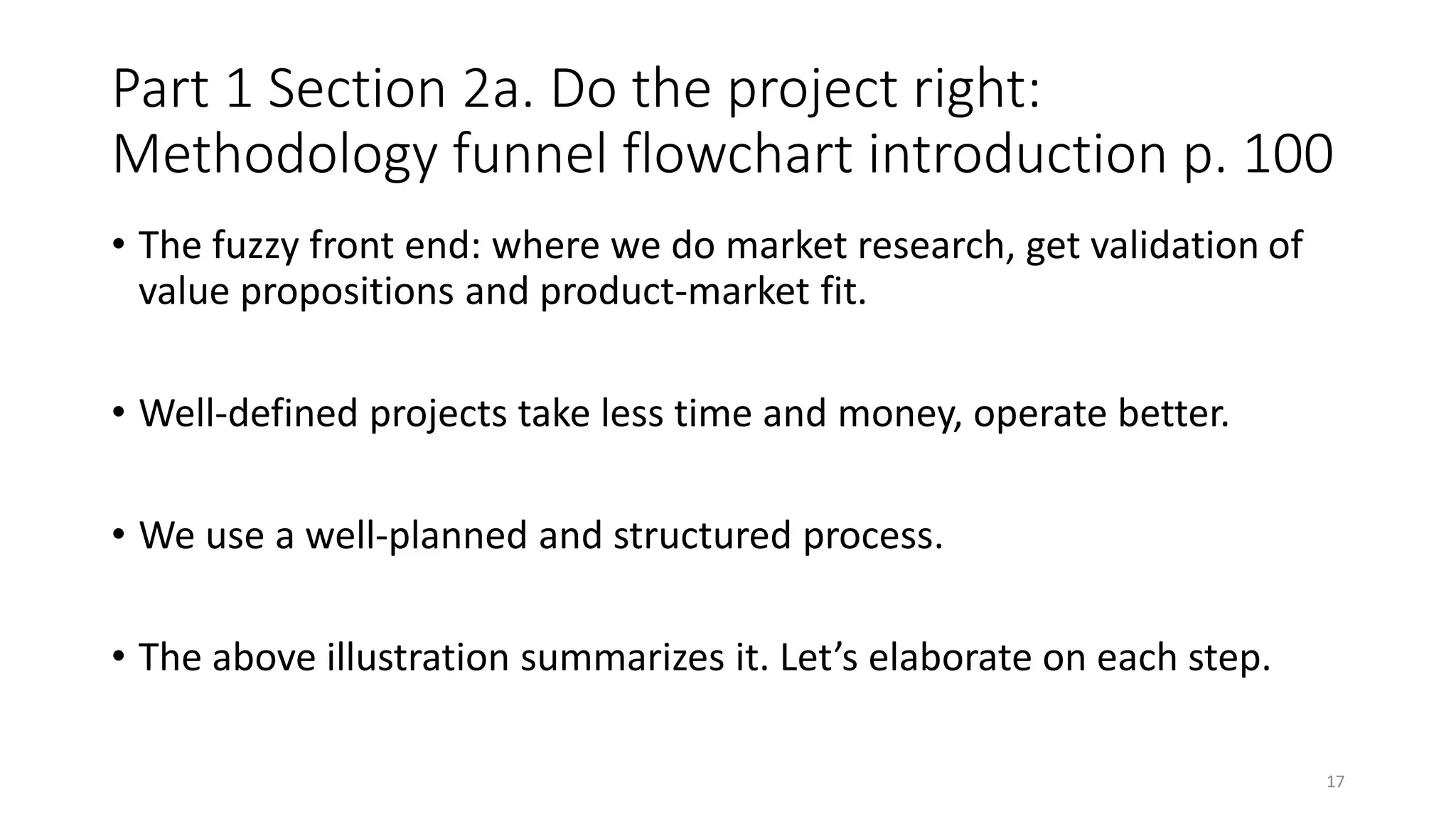

Part 1 Section 2a. Do the project right:
Methodology funnel flowchart introduction p. 100
• The fuzzy front end: where we do market research, get validation of
value propositions and product-market fit.
• Well-defined projects take less time and money, operate better.
• We use a well-planned and structured process.
• The above illustration summarizes it. Let’s elaborate on each step.
17

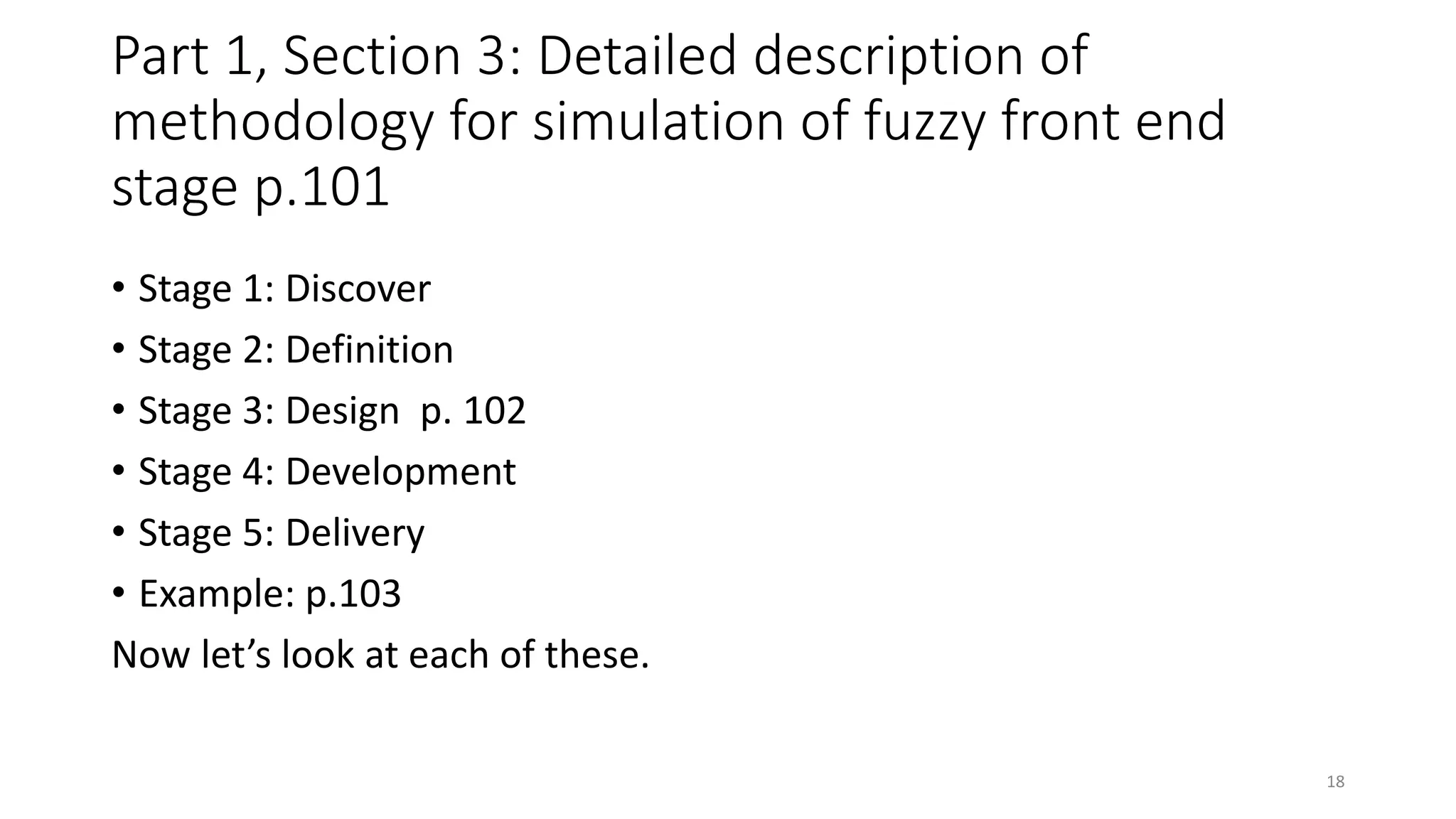

Part 1, Section 3: Detailed description of
methodology for simulation of fuzzy front end
stage p.101
• Stage 1: Discover
• Stage 2: Definition
• Stage 3: Design p. 102
• Stage 4: Development
• Stage 5: Delivery
• Example: p.103
Now let’s look at each of these.
18

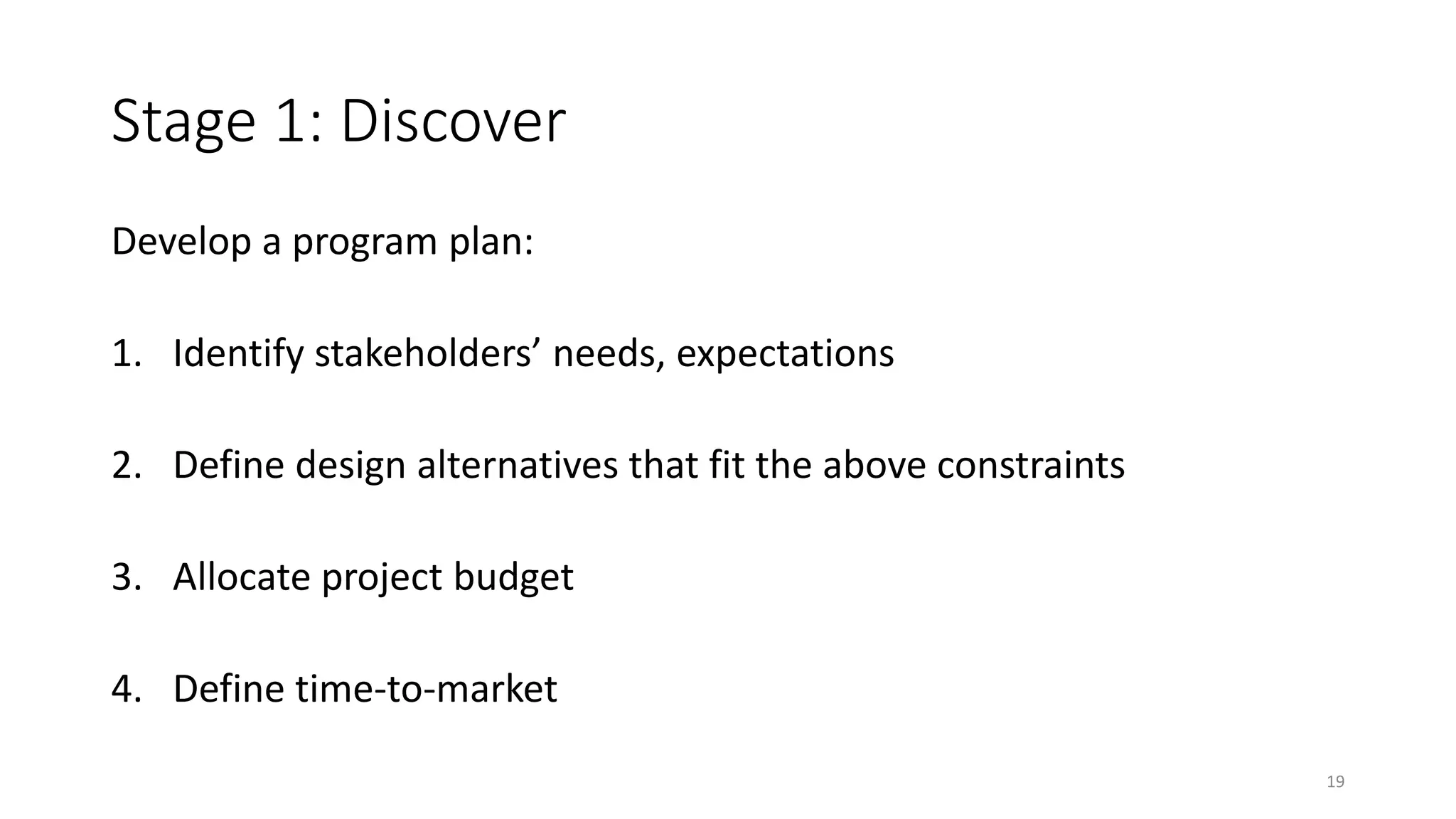

Stage 1: Discover
Develop a program plan:
1. Identify stakeholders’ needs, expectations
2. Define design alternatives that fit the above constraints
3. Allocate project budget
4. Define time-to-market
19

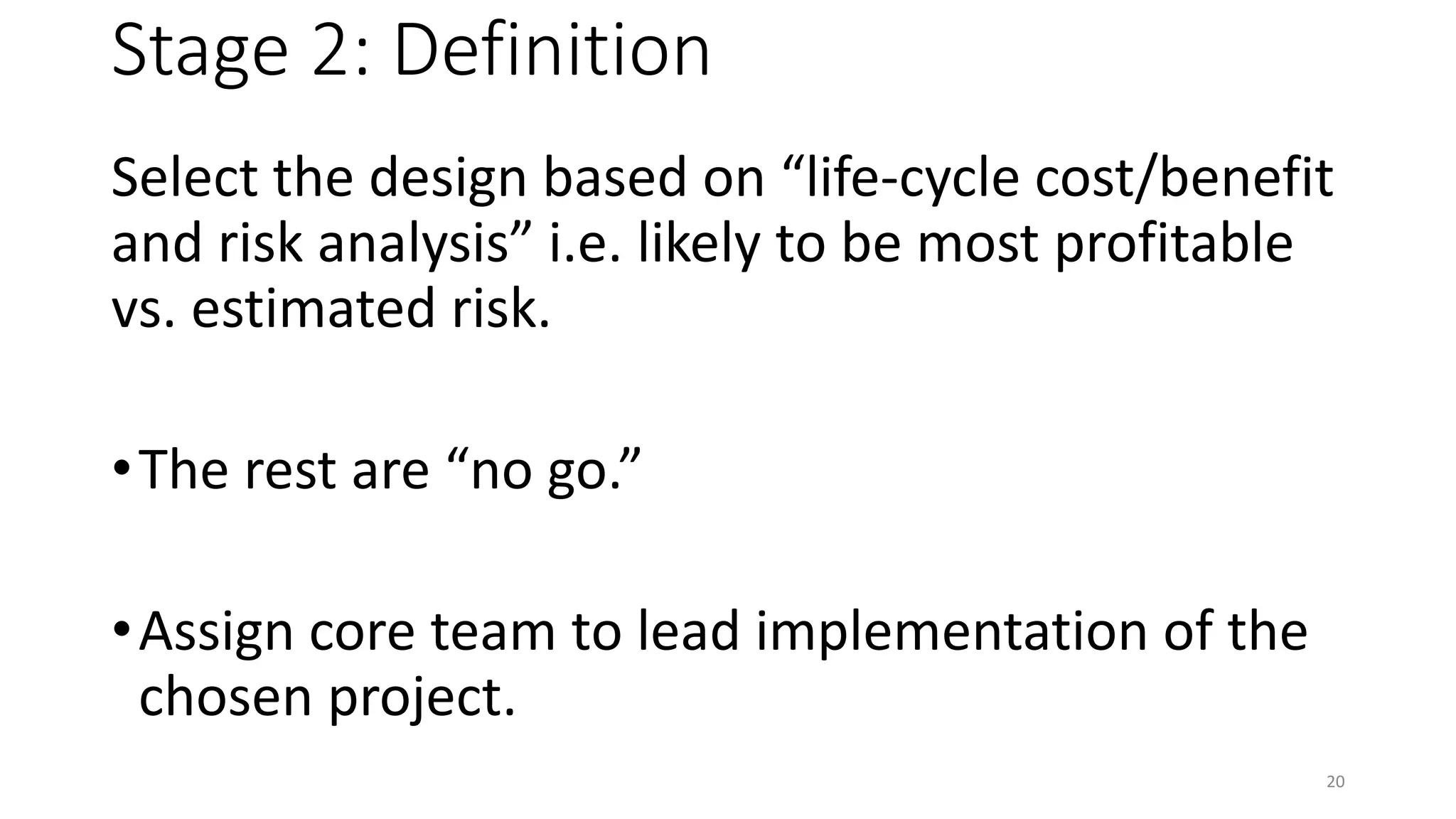

Stage 2: Definition
Select the design based on “life-cycle cost/benefit
and risk analysis” i.e. likely to be most profitable
vs. estimated risk.
•The rest are “no go.”
•Assign core team to lead implementation of the
chosen project.
20

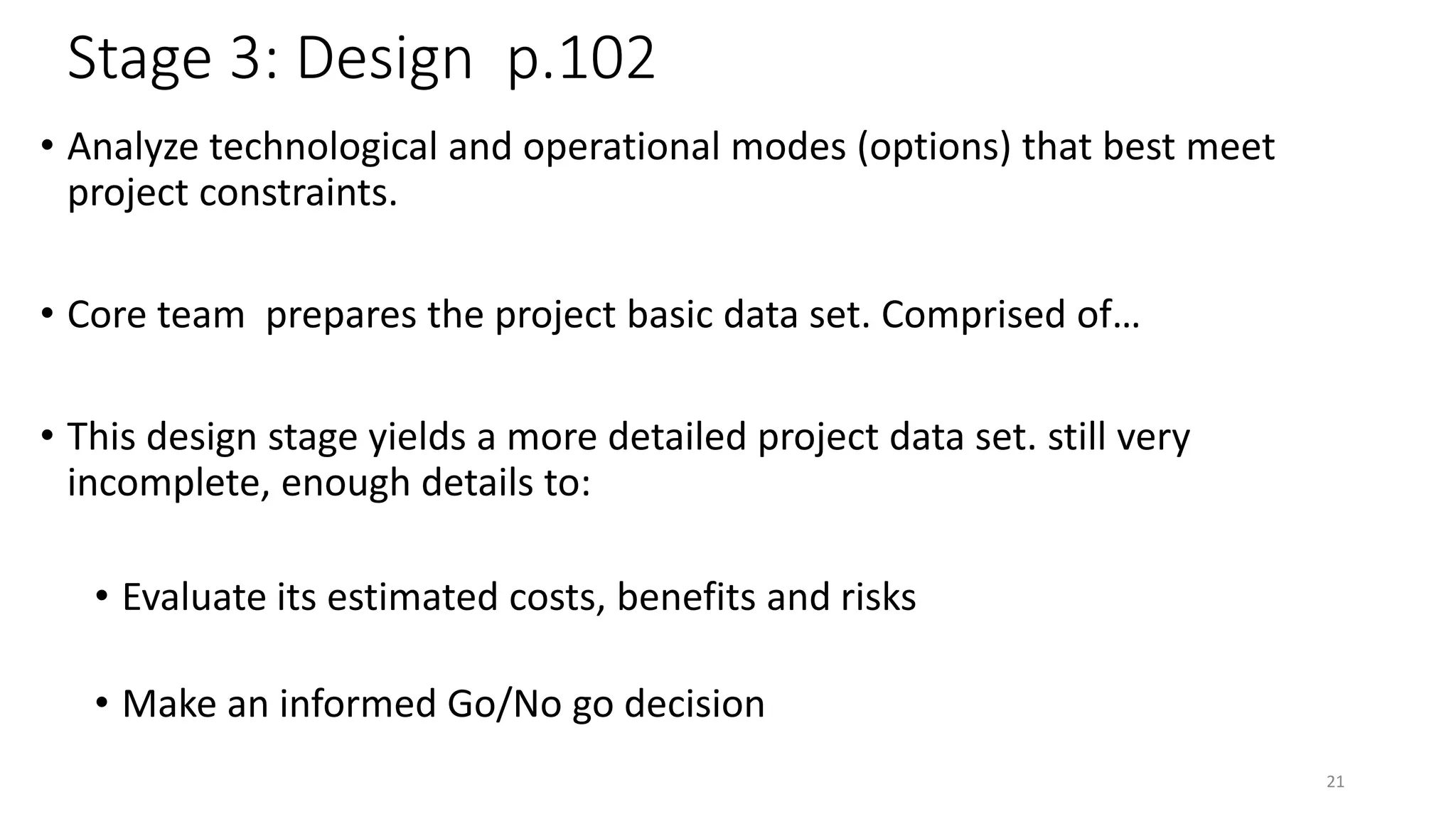

Stage 3: Design p.102
• Analyze technological and operational modes (options) that best meet
project constraints.
• Core team prepares the project basic data set. Comprised of…
• This design stage yields a more detailed project data set. still very
incomplete, enough details to:
• Evaluate its estimated costs, benefits and risks
• Make an informed Go/No go decision
21

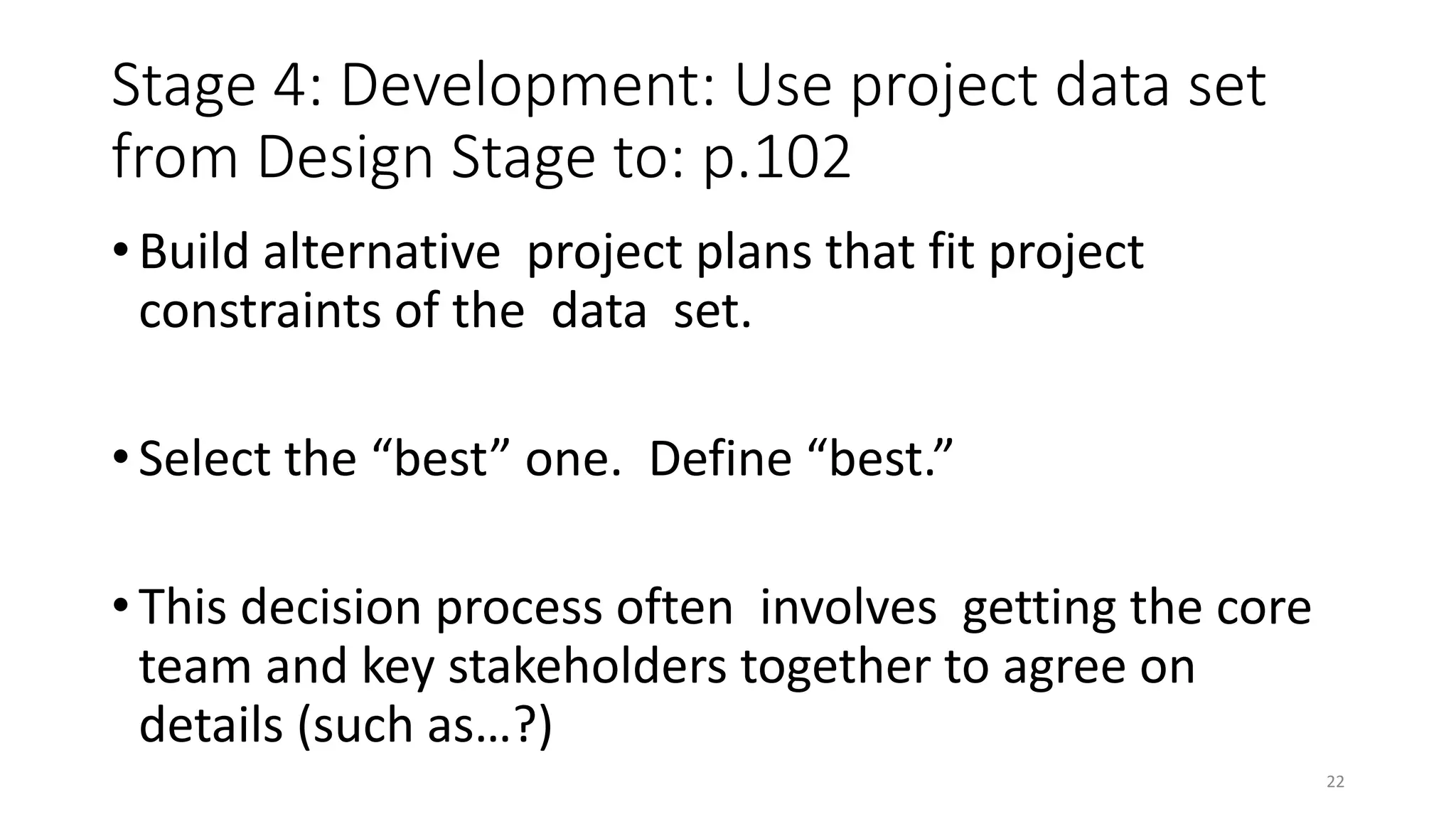

Stage 4: Development: Use project data set
from Design Stage to: p.102
• Build alternative project plans that fit project
constraints of the data set.
• Select the “best” one. Define “best.”
• This decision process often involves getting the core
team and key stakeholders together to agree on
details (such as…?)
22

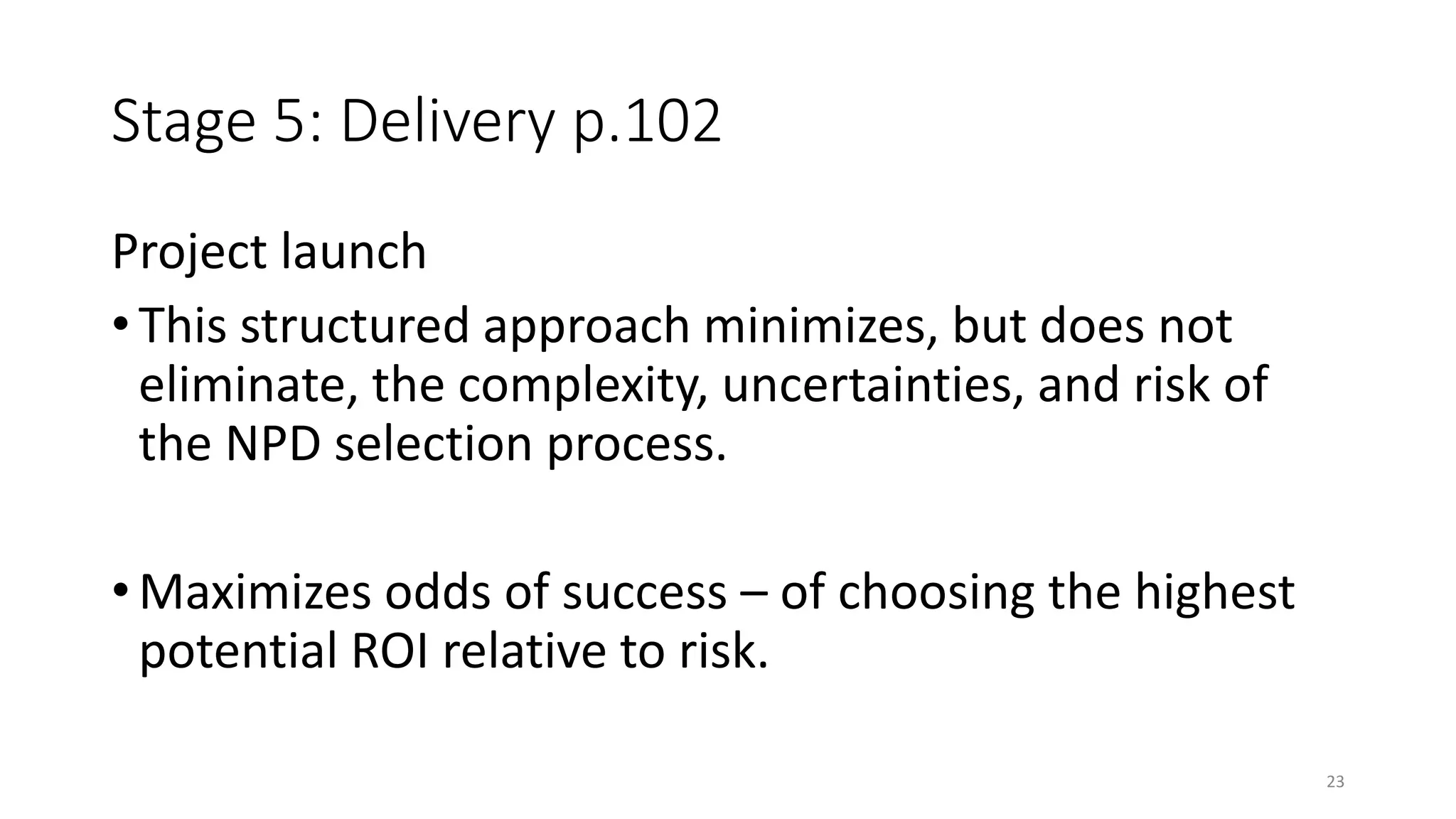

Stage 5: Delivery p.102
Project launch
• This structured approach minimizes, but does not
eliminate, the complexity, uncertainties, and risk of
the NPD selection process.
• Maximizes odds of success – of choosing the highest
potential ROI relative to risk.
23

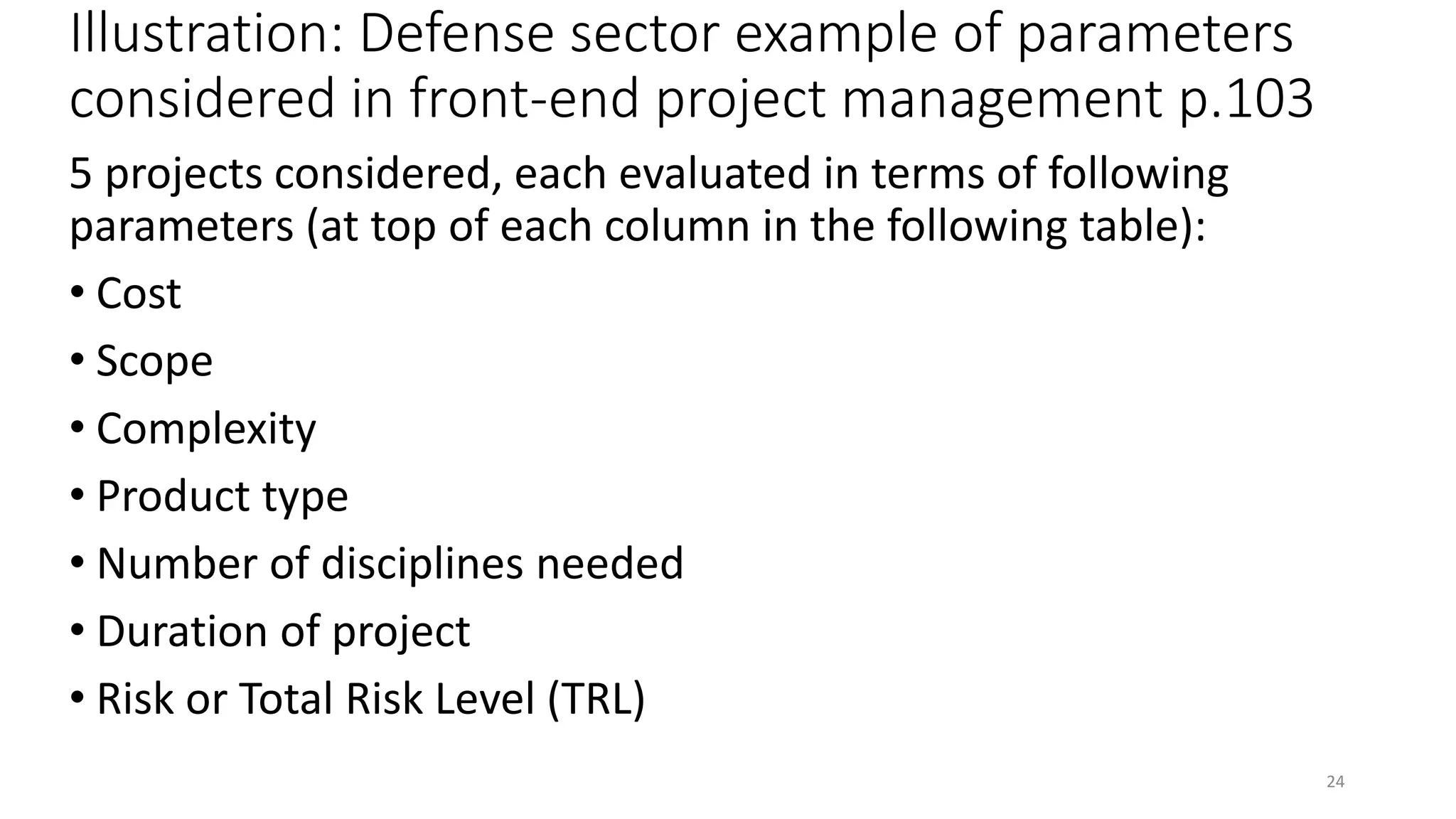

Illustration: Defense sector example of parameters
considered in front-end project management p.103
5 projects considered, each evaluated in terms of following
parameters (at top of each column in the following table):
• Cost
• Scope
• Complexity
• Product type
• Number of disciplines needed
• Duration of project
• Risk or Total Risk Level (TRL)
24

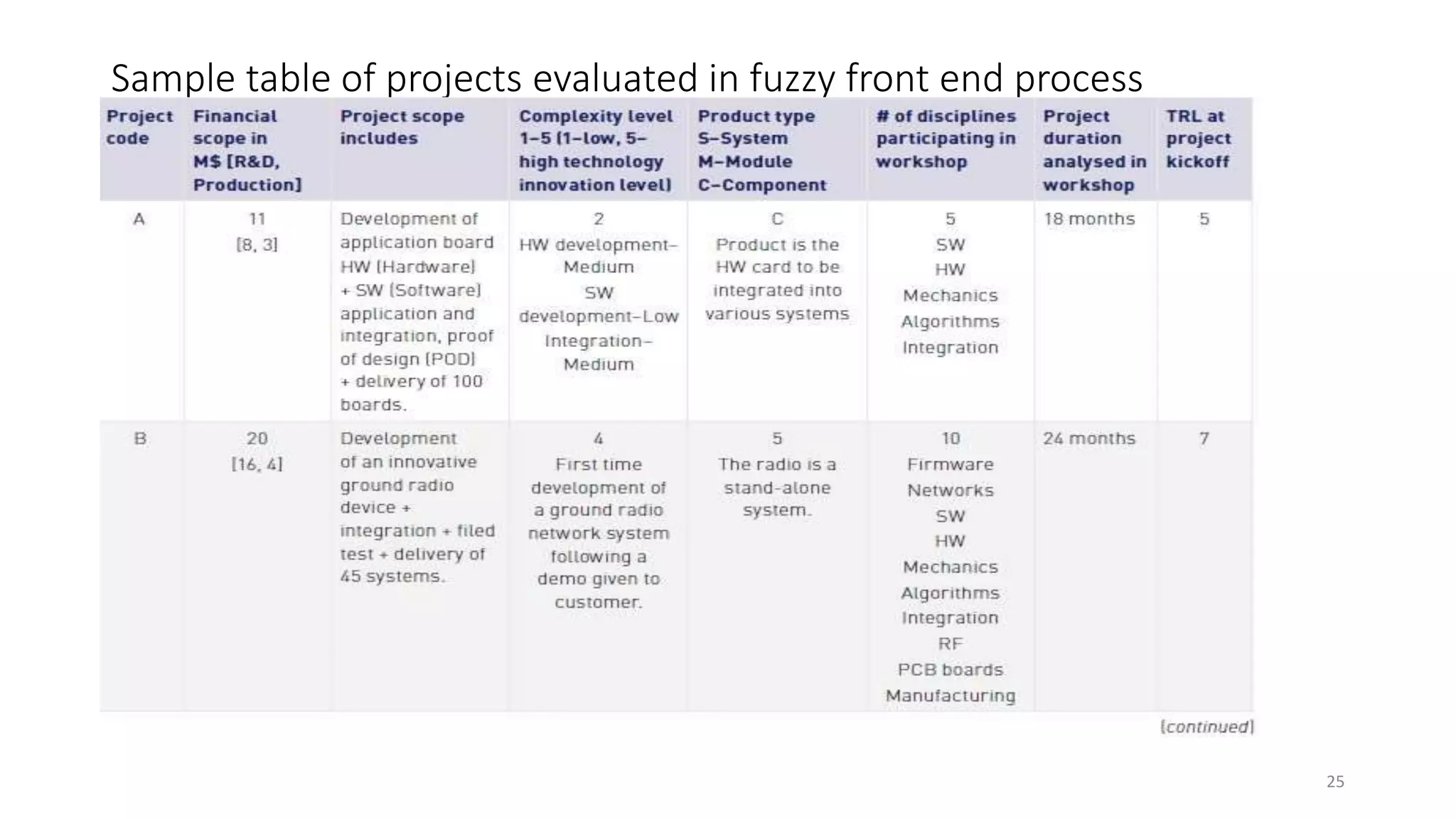

Sample table of projects evaluated in fuzzy front end process
25
Sample table of projects evaluated in fuzzy front end process (cont’d 1)
26

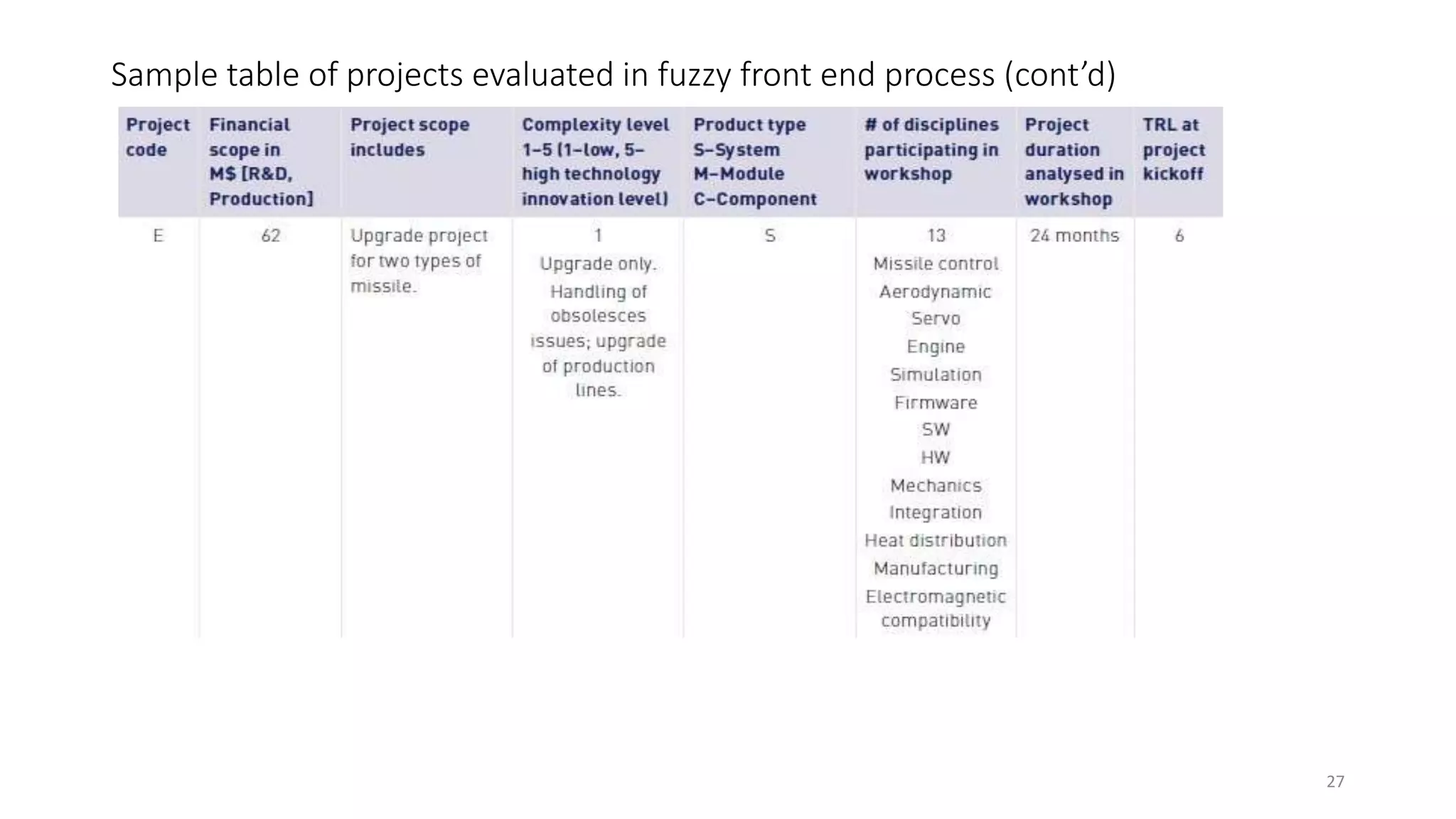

Sample table of projects evaluated in fuzzy front end process (cont’d)
27

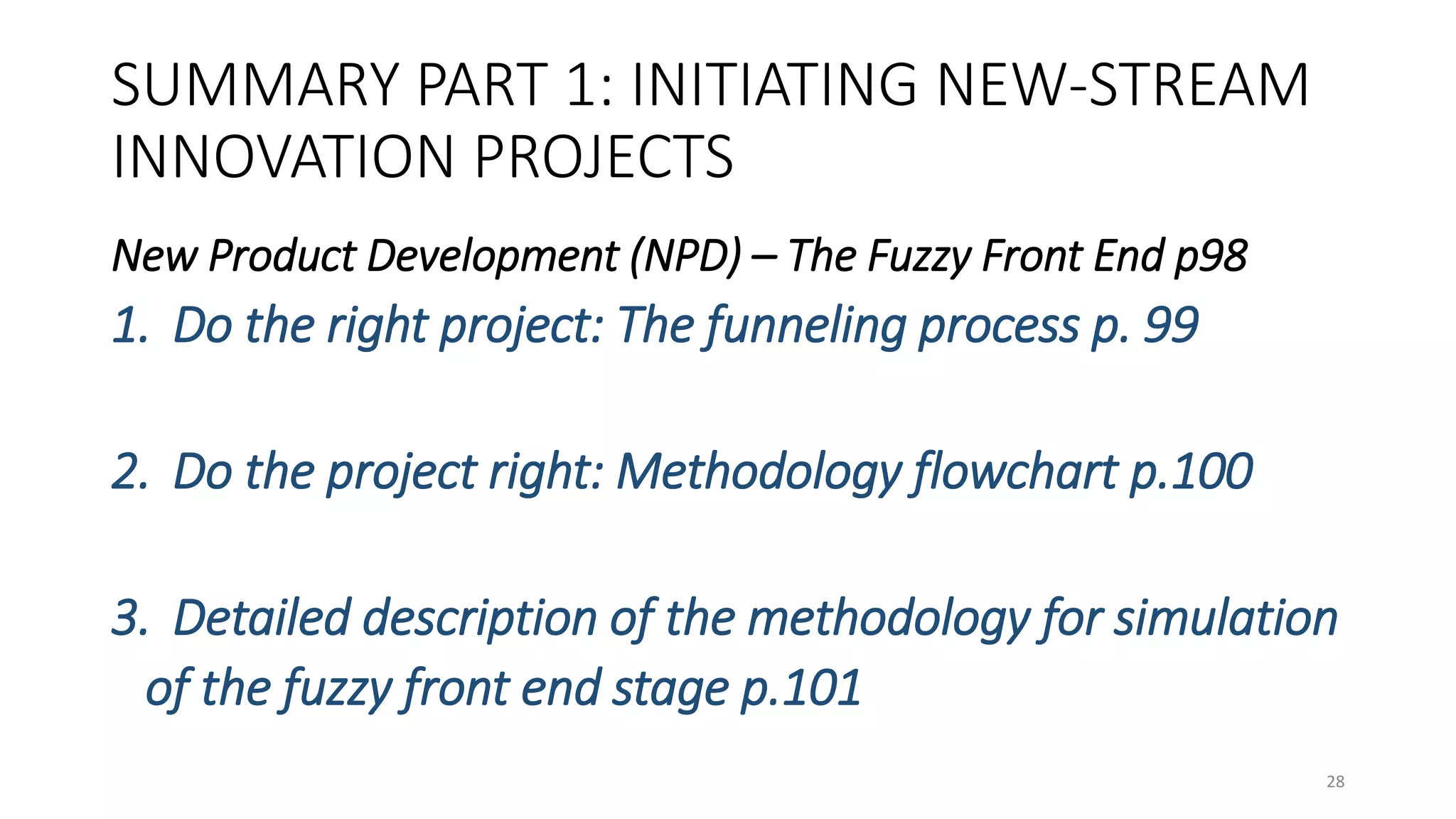

SUMMARY PART 1: INITIATING NEW-STREAM
INNOVATION PROJECTS
New Product Development (NPD) – The Fuzzy Front End p98
1. Do the right project: The funneling process p. 99
2. Do the project right: Methodology flowchart p.100
3. Detailed description of the methodology for simulation
of the fuzzy front end stage p.101
28
PART 2: MANAGING AND EVALUATING INDIVIDUAL
INNOVATION IDEAS THROUGH THE PIPELINE p.107
29

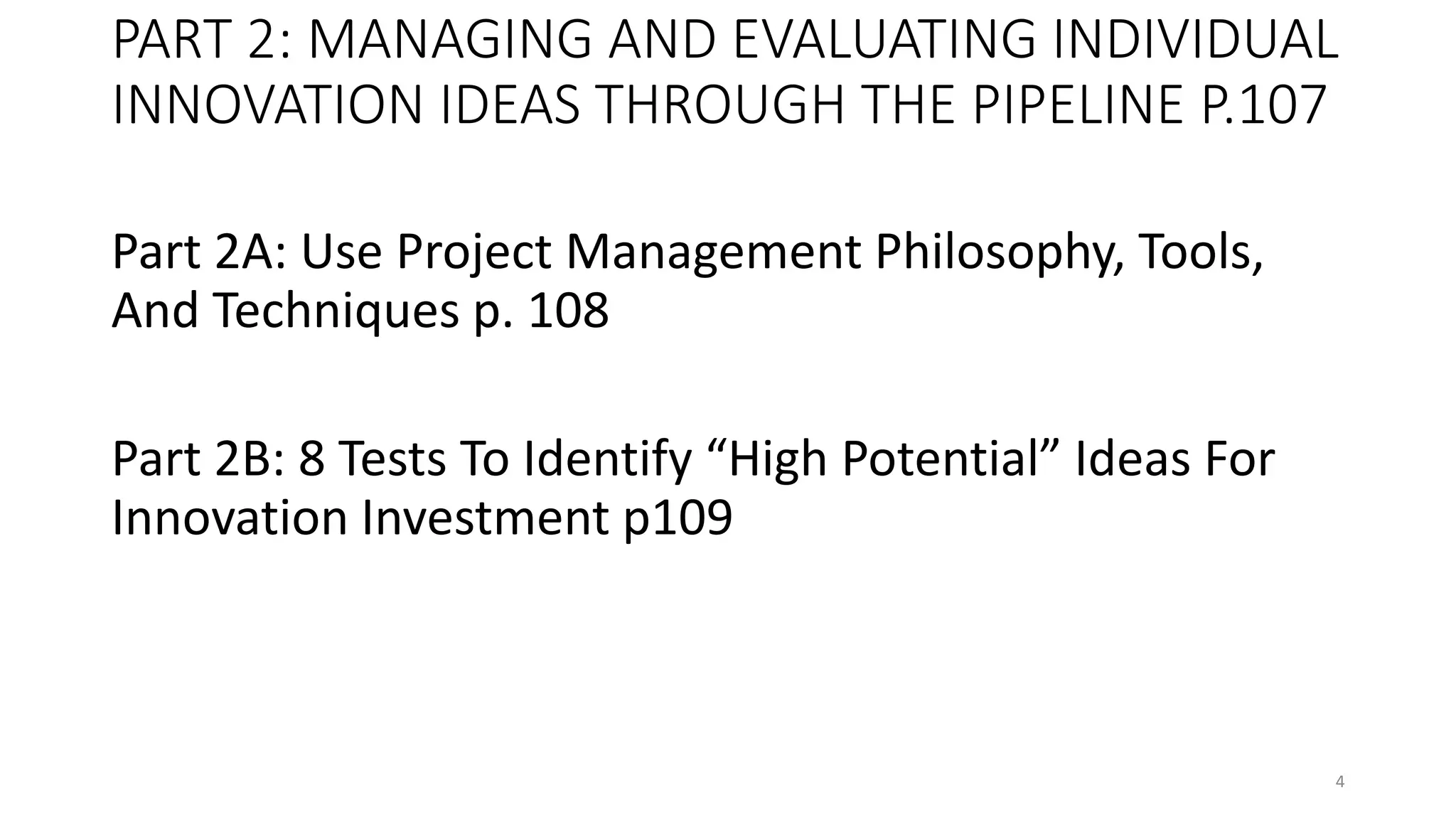

PART 2: MANAGING AND EVALUATING
INDIVIDUAL INNOVATION IDEAS THROUGH
THE PIPELINE p.107
•Introduction p.p. 107
•2A: Use Project Management Philosophy, Tools, And
Techniques p.108
•2B: 8 Tests To Identify “High Potential” Ideas For
Innovation Investment p.109
30

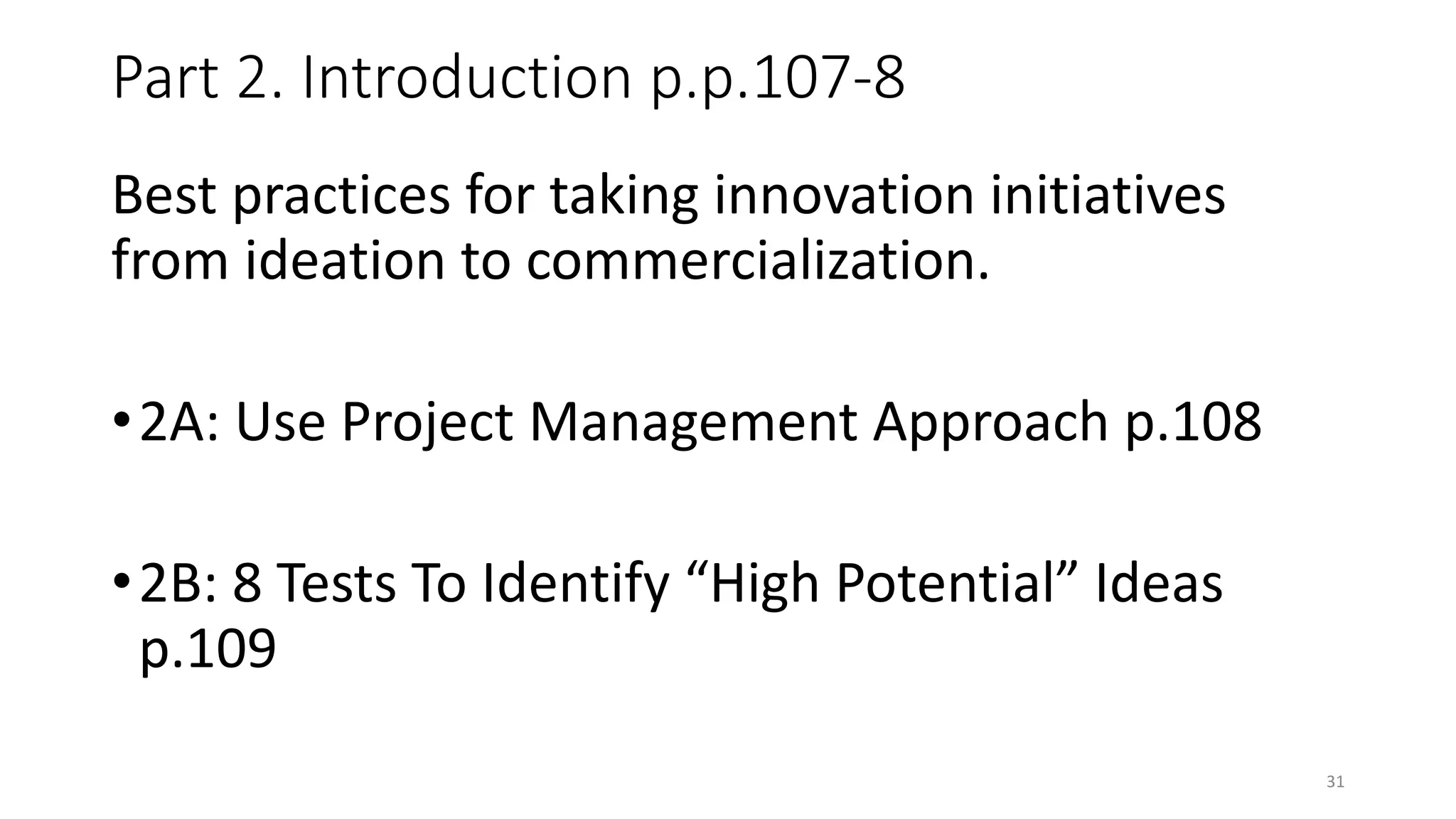

Part 2. Introduction p.p.107-8
Best practices for taking innovation initiatives
from ideation to commercialization.
•2A: Use Project Management Approach p.108
•2B: 8 Tests To Identify “High Potential” Ideas
p.109
31

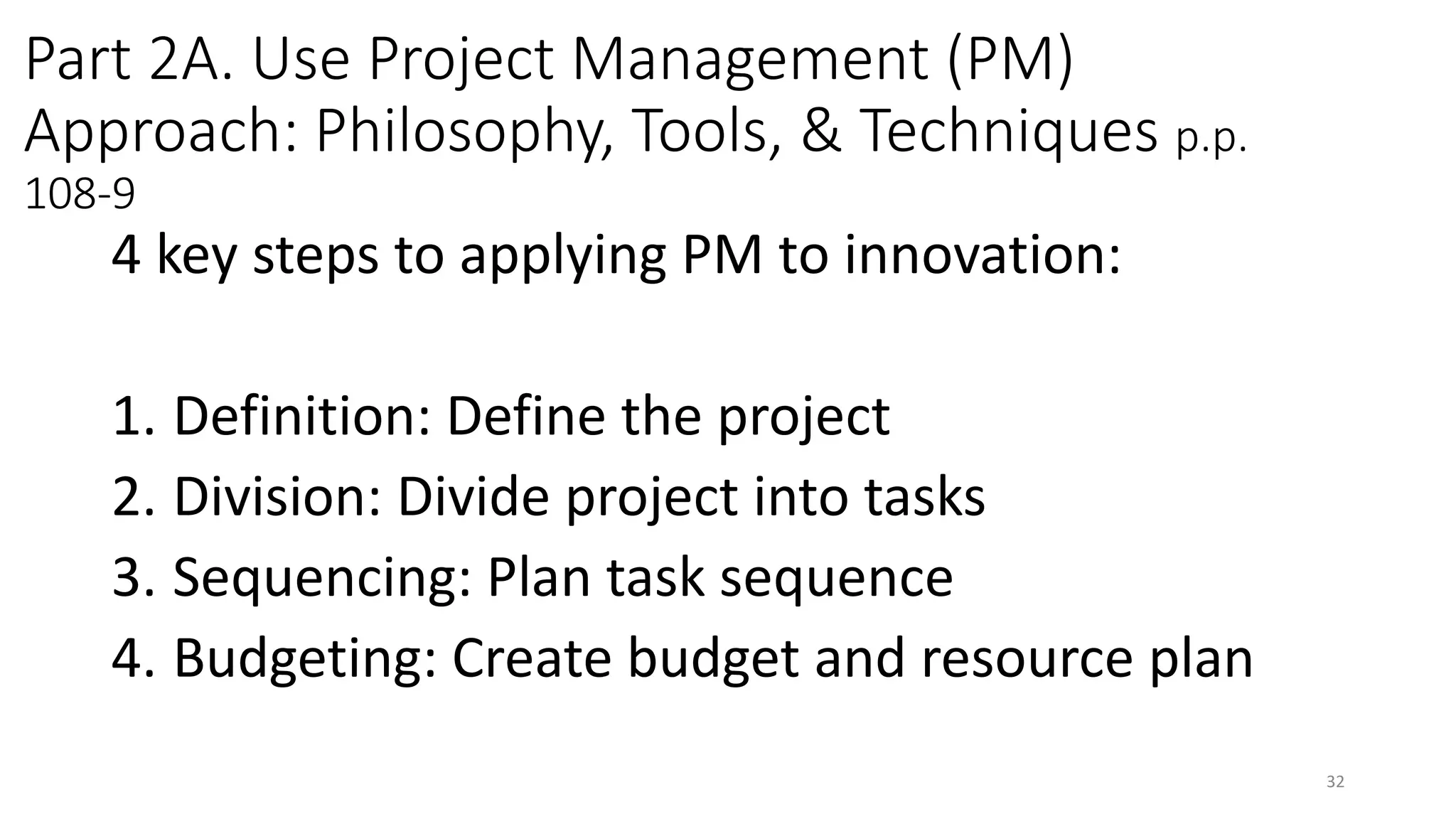

Part 2A. Use Project Management (PM)
Approach: Philosophy, Tools, & Techniques p.p.
108-9
4 key steps to applying PM to innovation:
1. Definition: Define the project
2. Division: Divide project into tasks
3. Sequencing: Plan task sequence
4. Budgeting: Create budget and resource plan
32
Step 1: Defining the project p. 108
•Define scope and objectives.
•Identify the consumer and other relevant
stakeholders.
•Clarify resources needed.
33

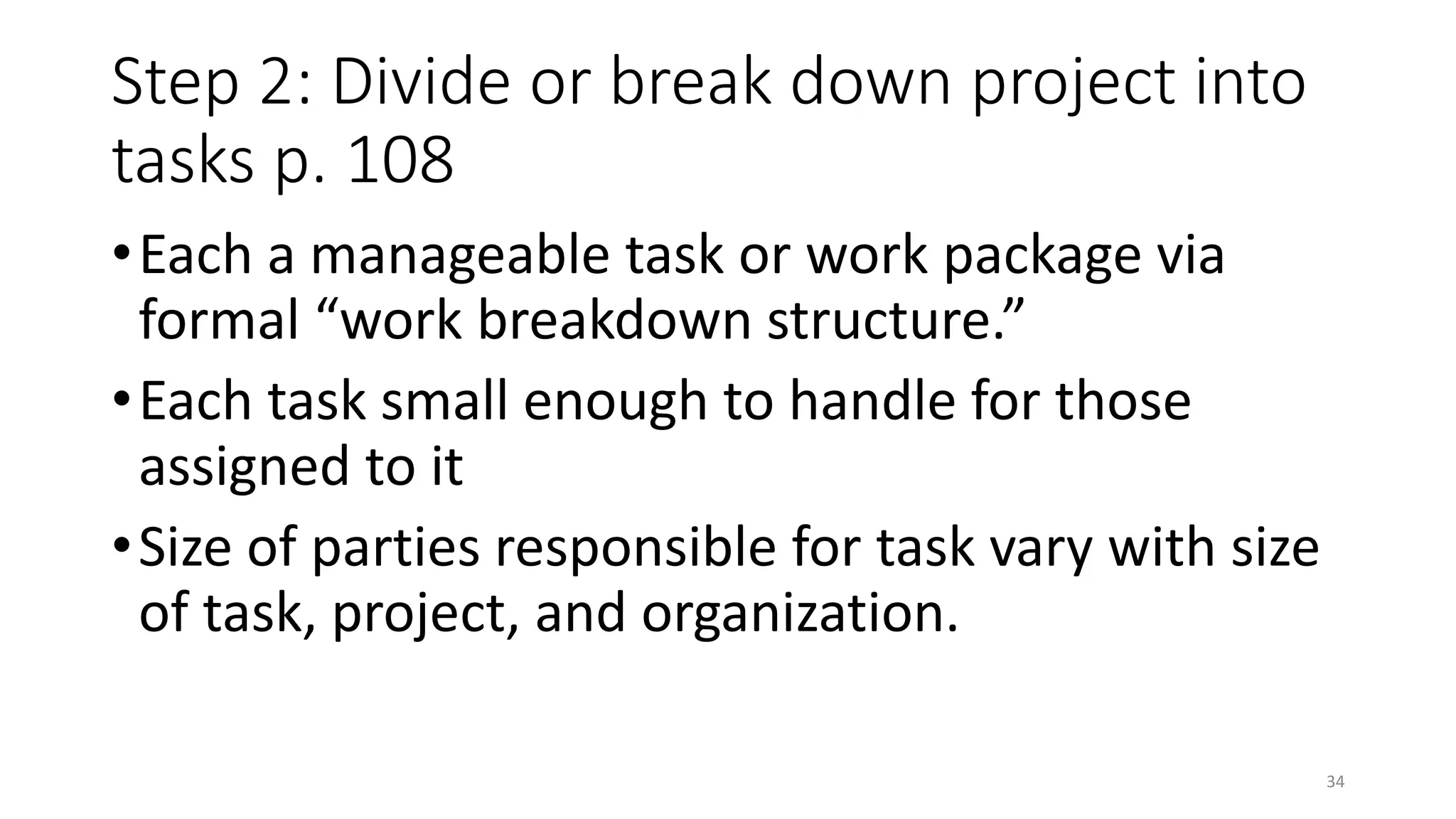

Step 2: Divide or break down project into
tasks p. 108
•Each a manageable task or work package via
formal “work breakdown structure.”
•Each task small enough to handle for those
assigned to it
•Size of parties responsible for task vary with size
of task, project, and organization.
34

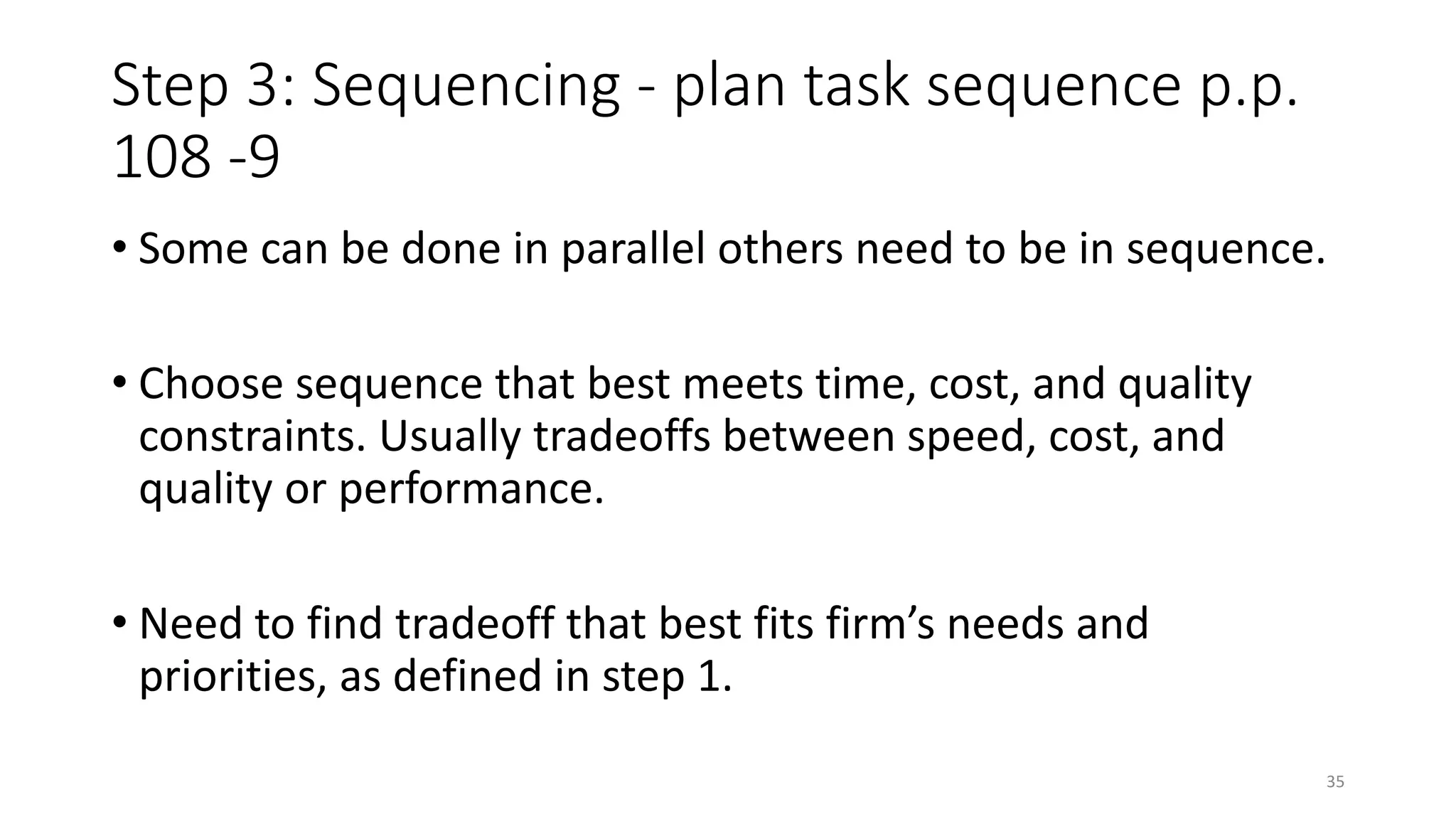

Step 3: Sequencing - plan task sequence p.p.
108 -9
• Some can be done in parallel others need to be in sequence.
• Choose sequence that best meets time, cost, and quality
constraints. Usually tradeoffs between speed, cost, and
quality or performance.
• Need to find tradeoff that best fits firm’s needs and
priorities, as defined in step 1.
35

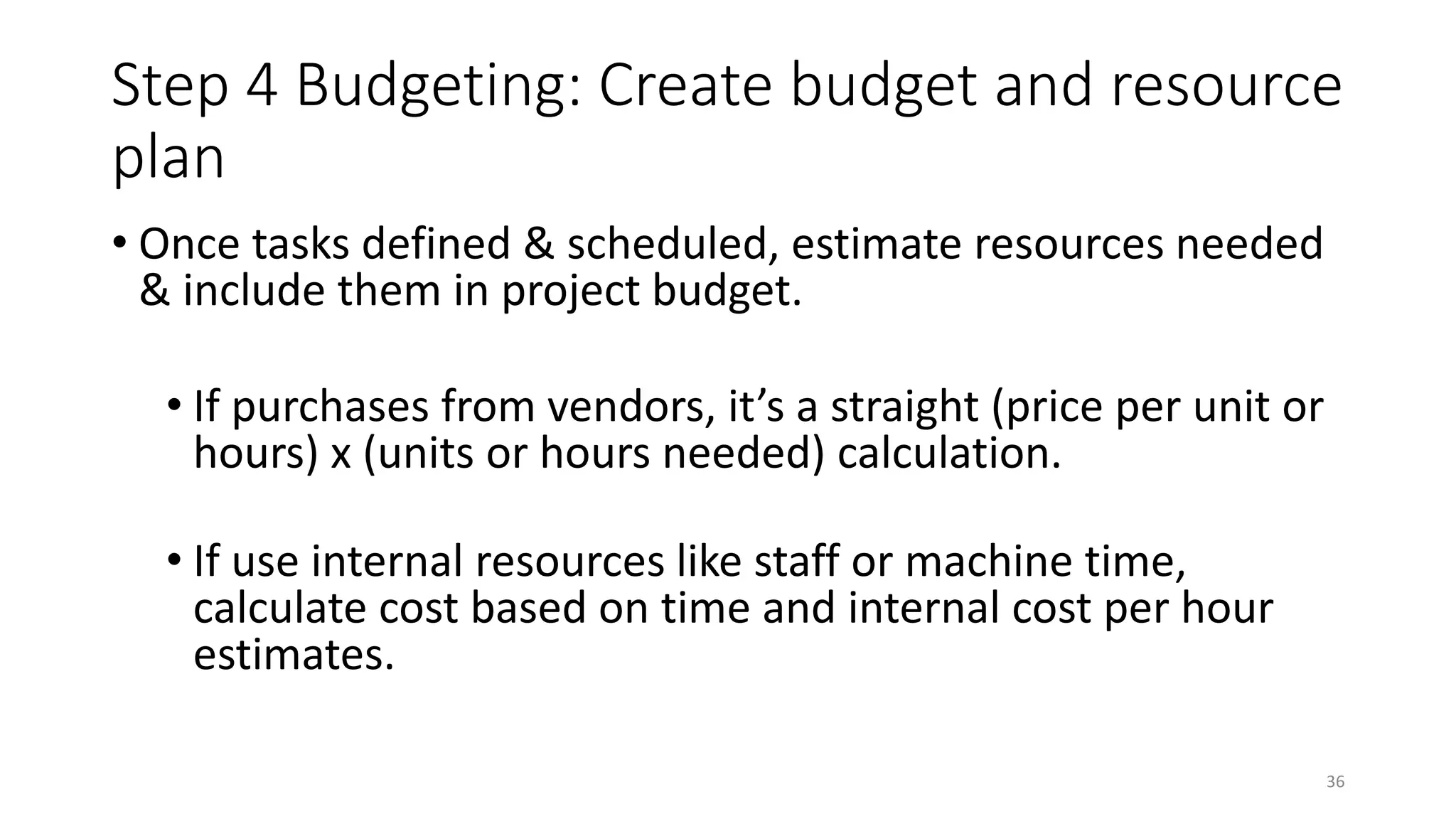

Step 4 Budgeting: Create budget and resource
plan
• Once tasks defined & scheduled, estimate resources needed
& include them in project budget.
• If purchases from vendors, it’s a straight (price per unit or
hours) x (units or hours needed) calculation.
• If use internal resources like staff or machine time,
calculate cost based on time and internal cost per hour
estimates.
36
Remember: Innovation requires creativity and….
DISCIPLINE
37

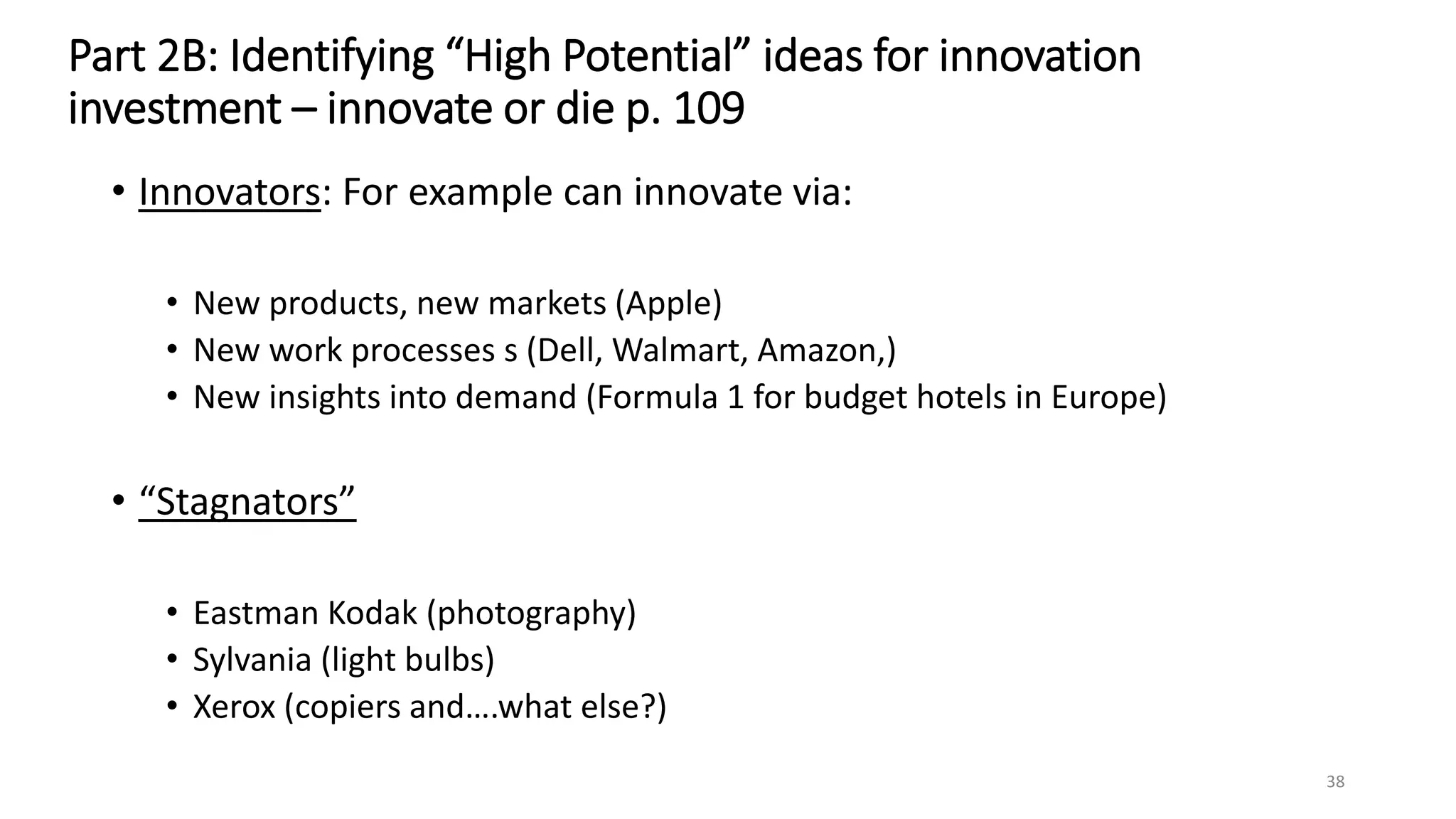

Part 2B: Identifying “High Potential” ideas for innovation
investment – innovate or die p. 109
• Innovators: For example can innovate via:
• New products, new markets (Apple)
• New work processes s (Dell, Walmart, Amazon,)
• New insights into demand (Formula 1 for budget hotels in Europe)
• “Stagnators”
• Eastman Kodak (photography)
• Sylvania (light bulbs)
• Xerox (copiers and….what else?)
38
Can we distinguish winners from losers early on?

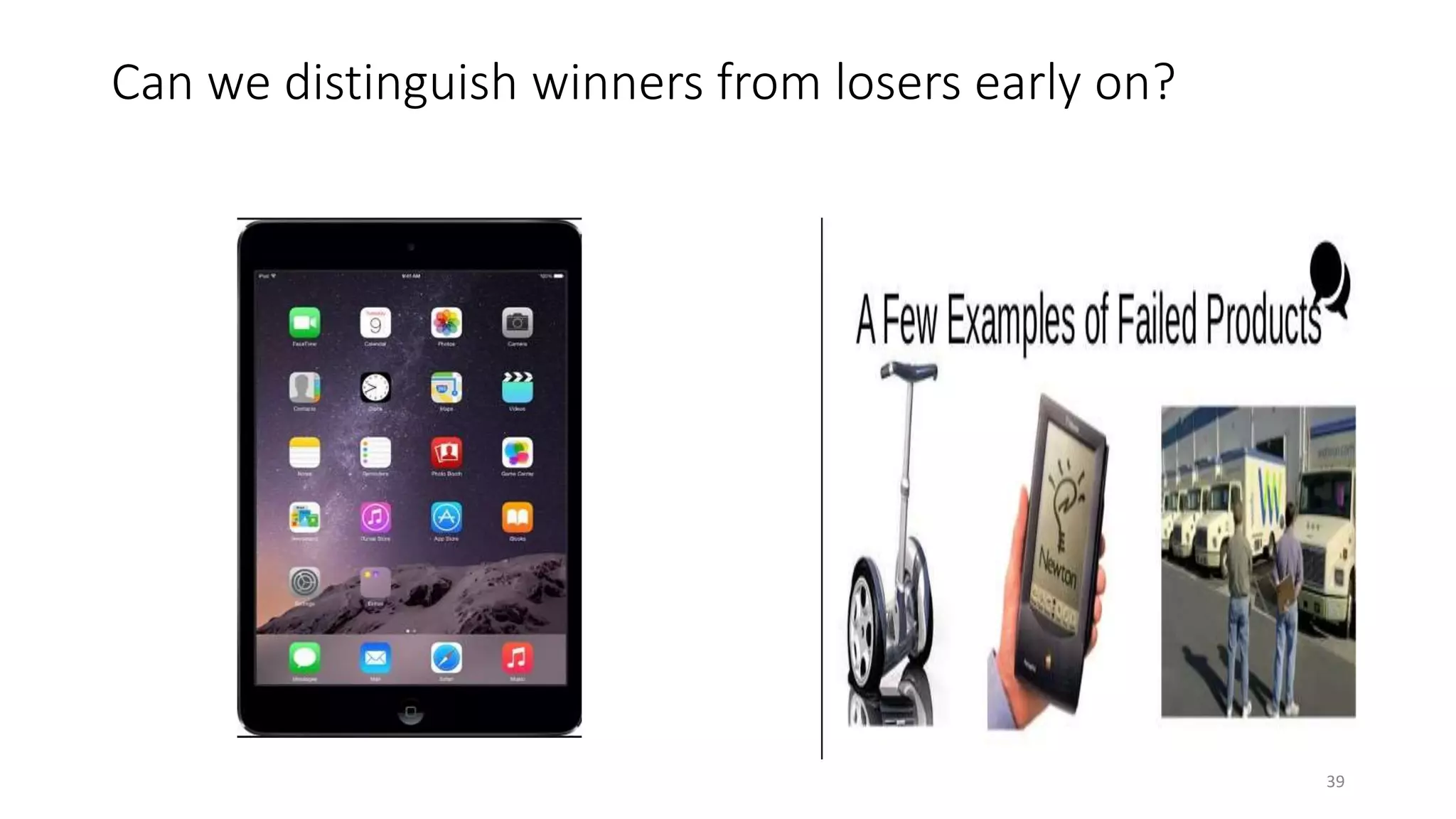

39

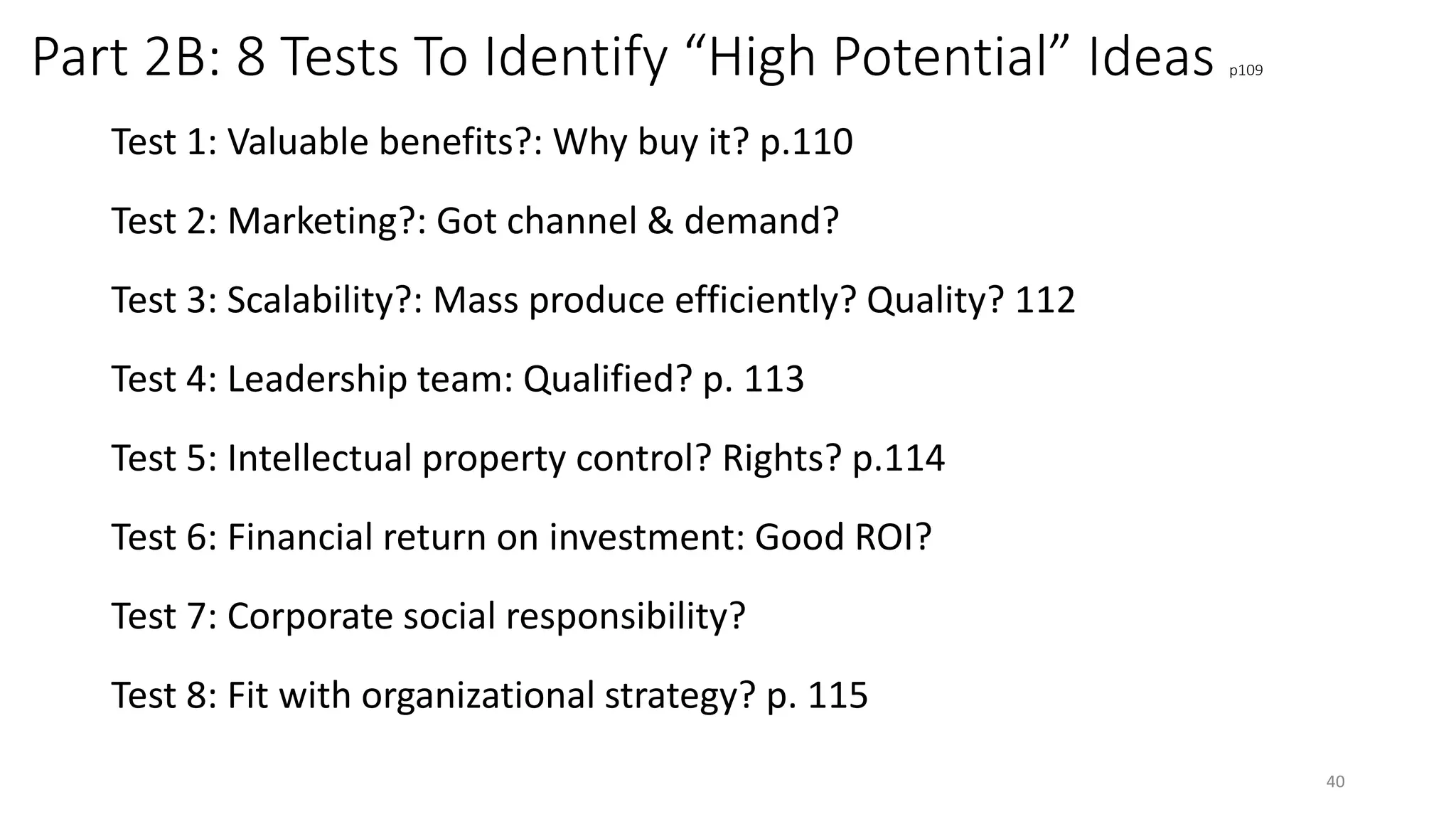

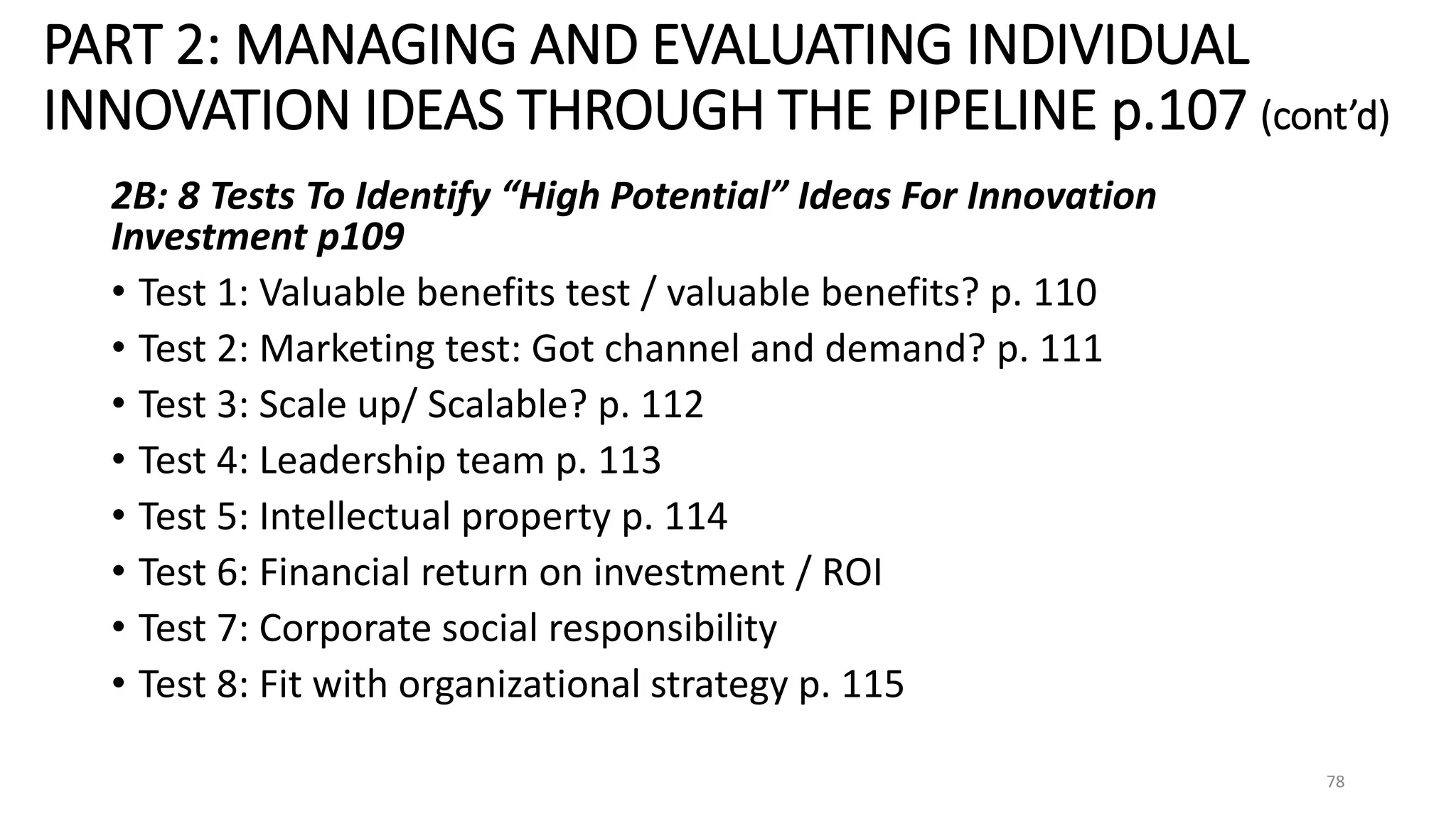

Part 2B: 8 Tests To Identify “High Potential” Ideas p109
Test 1: Valuable benefits?: Why buy it? p.110
Test 2: Marketing?: Got channel & demand?
Test 3: Scalability?: Mass produce efficiently? Quality? 112
Test 4: Leadership team: Qualified? p. 113
Test 5: Intellectual property control? Rights? p.114

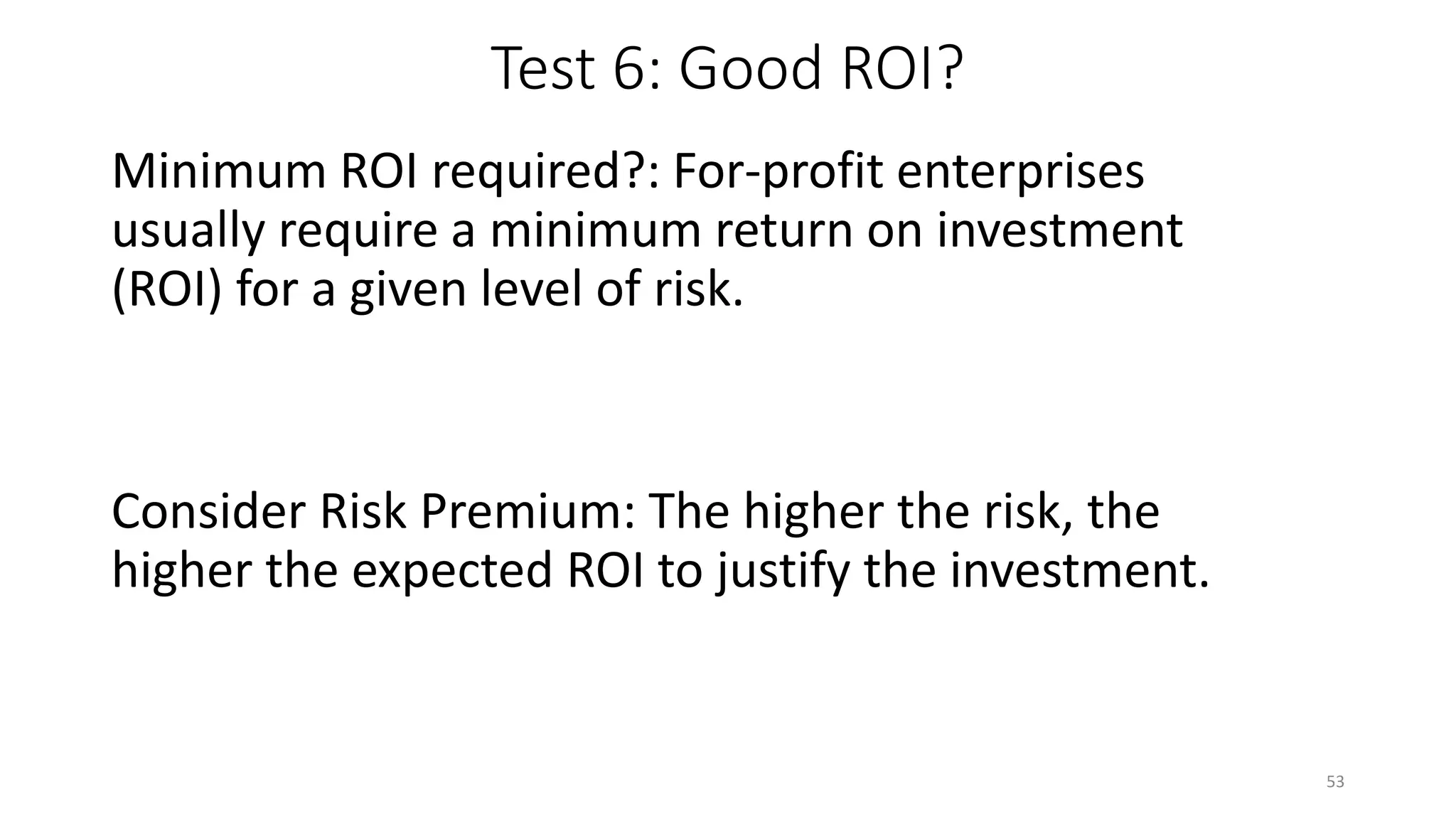

Test 6: Financial return on investment: Good ROI?
Test 7: Corporate social responsibility?

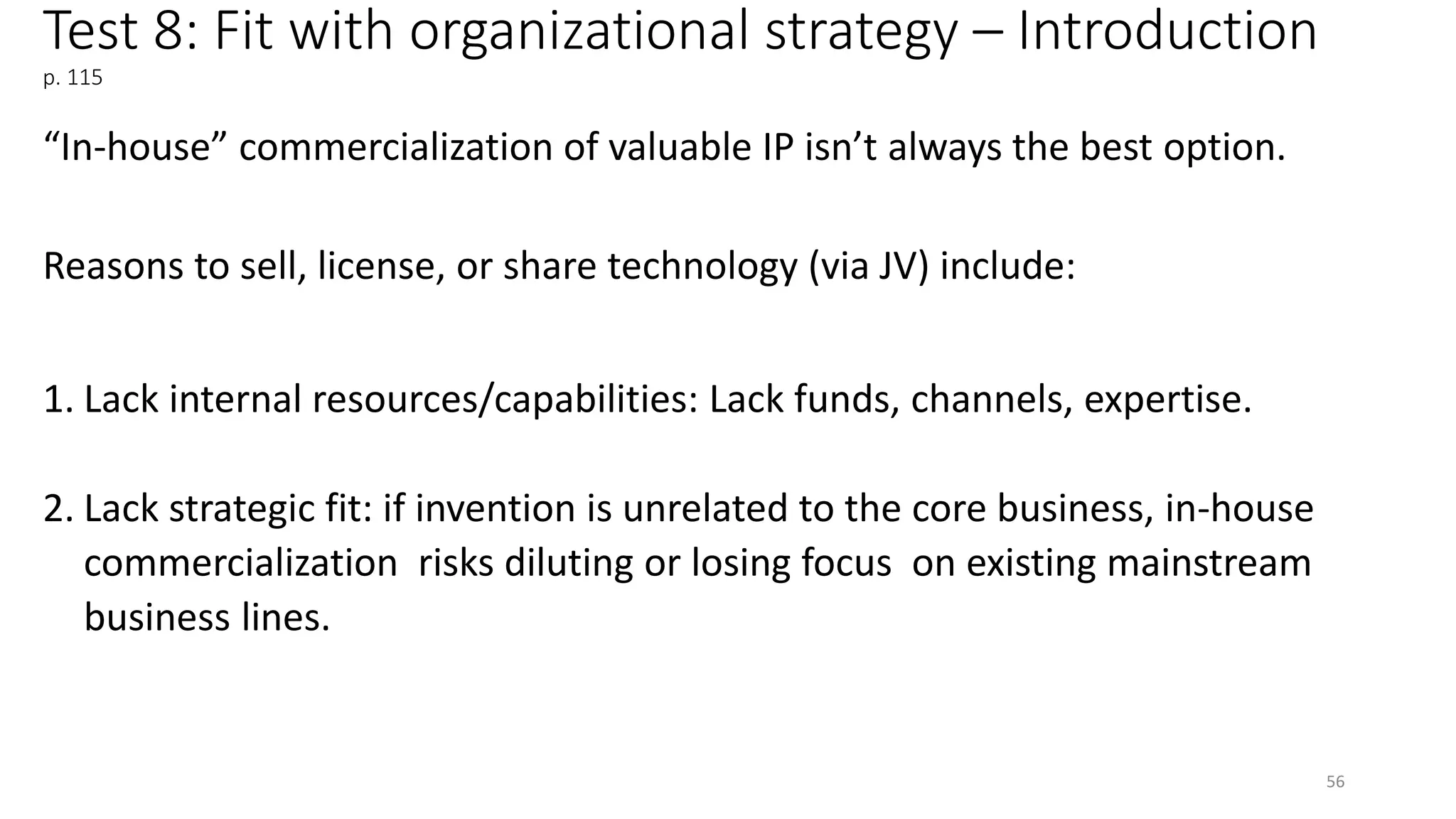

Test 8: Fit with organizational strategy? p. 115
40

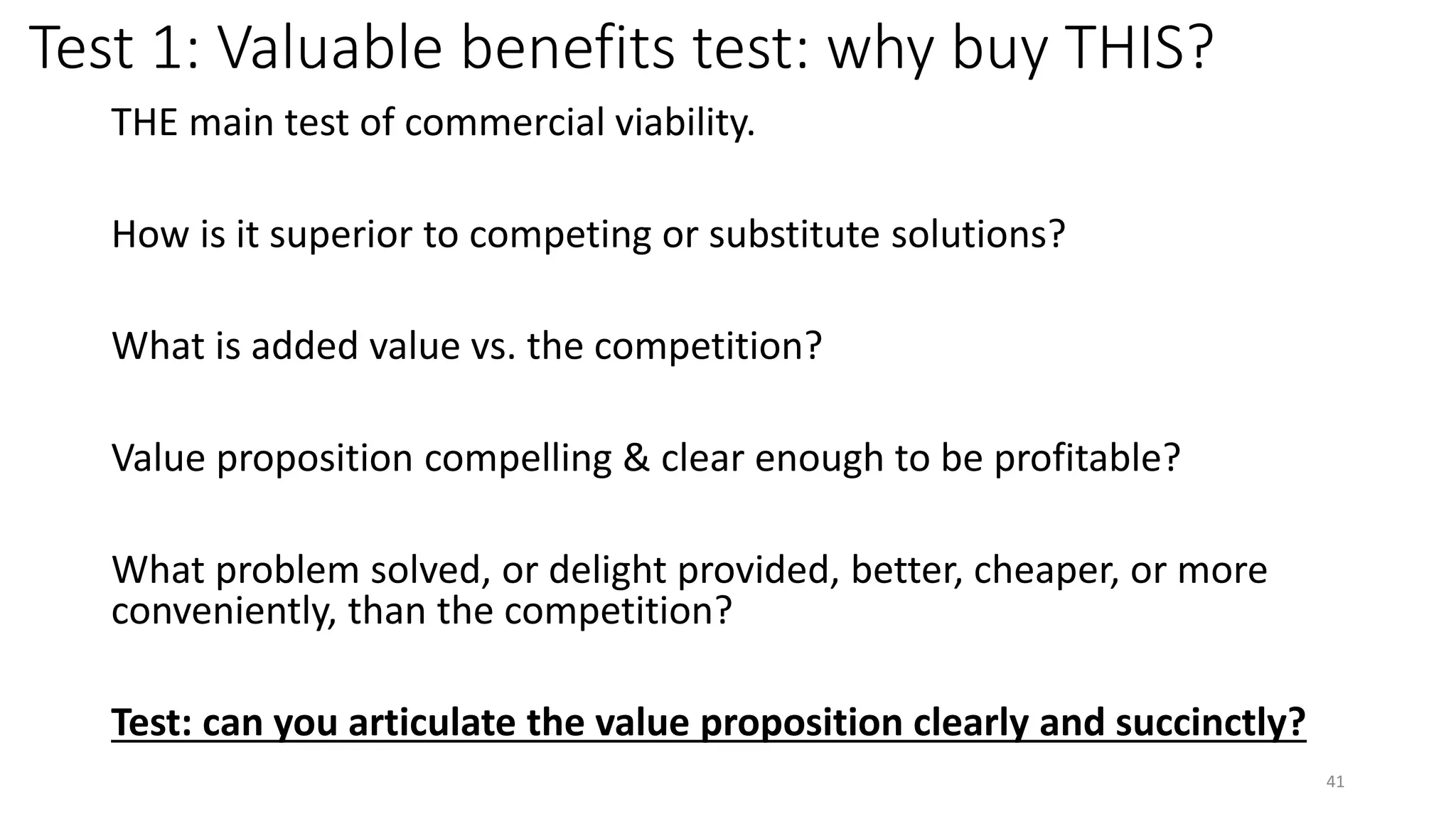

Test 1: Valuable benefits test: why buy THIS?
THE main test of commercial viability.
How is it superior to competing or substitute solutions?
What is added value vs. the competition?
Value proposition compelling & clear enough to be profitable?
What problem solved, or delight provided, better, cheaper, or more
conveniently, than the competition?
Test: can you articulate the value proposition clearly and succinctly?
41

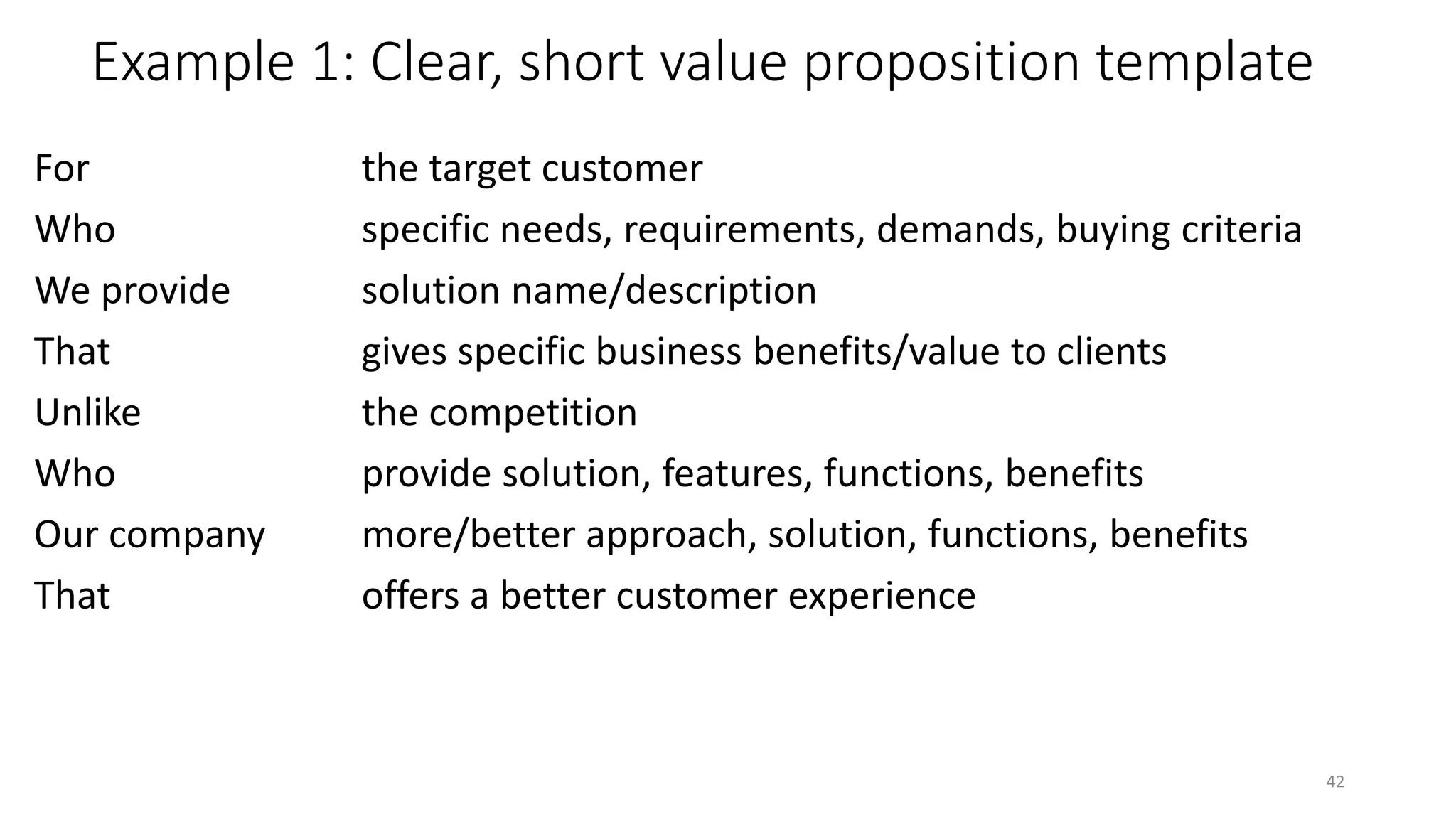

Example 1: Clear, short value proposition template
For the target customer
Who specific needs, requirements, demands, buying criteria
We provide solution name/description
That gives specific business benefits/value to clients
Unlike the competition
Who provide solution, features, functions, benefits
Our company more/better approach, solution, functions, benefits
That offers a better customer experience
42

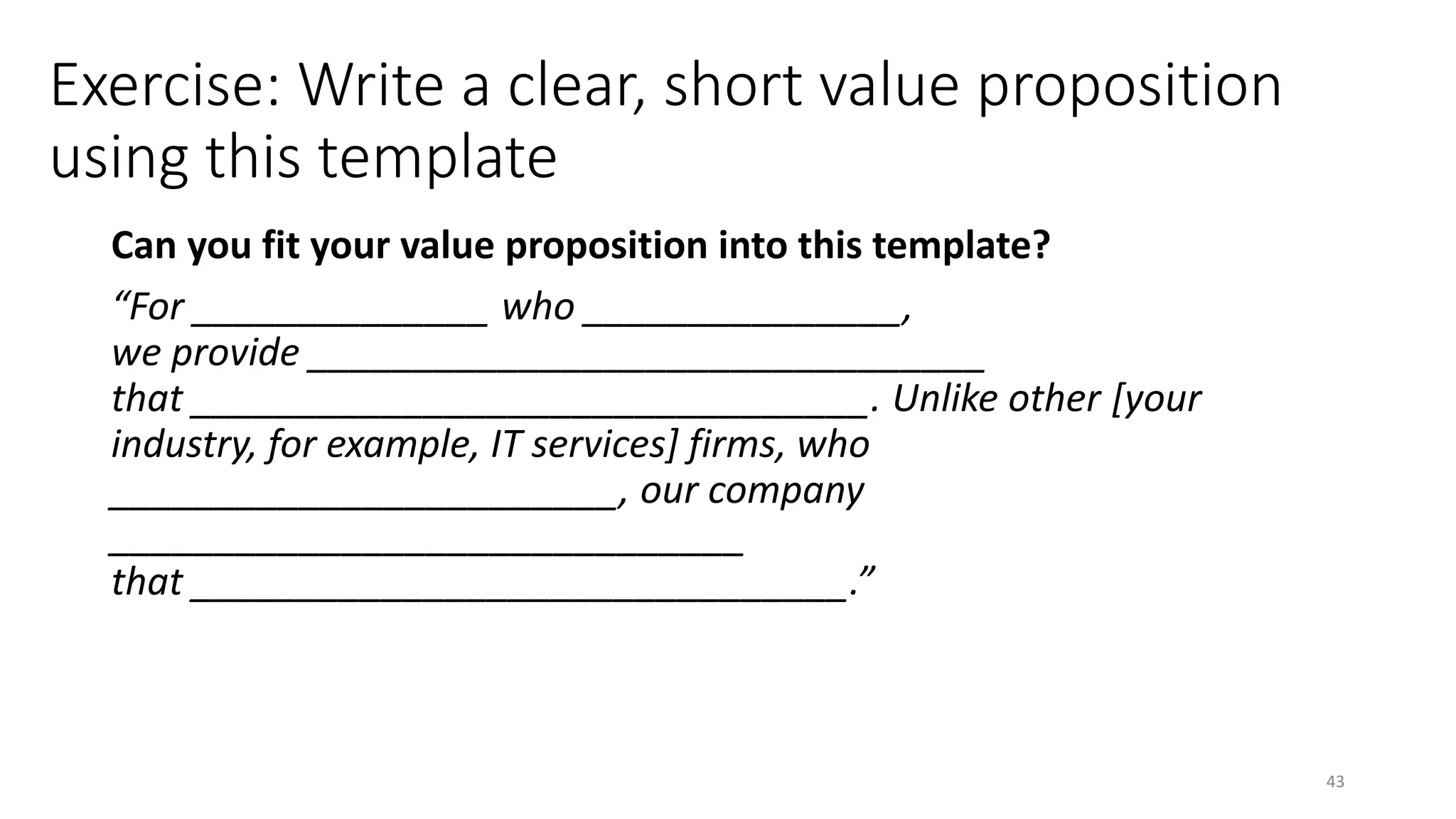

Exercise: Write a clear, short value proposition
using this template
Can you fit your value proposition into this template?
“For ______________ who _______________,
we provide ________________________________
that ________________________________. Unlike other [your
industry, for example, IT services] firms, who
________________________, our company
______________________________
that _______________________________.”
43
Test 2: Marketing: channel & demand? p. 111
1. Channels: Can we establish effective supply
chain & distribution channels?
2. Enough demand at profitable price point?
44

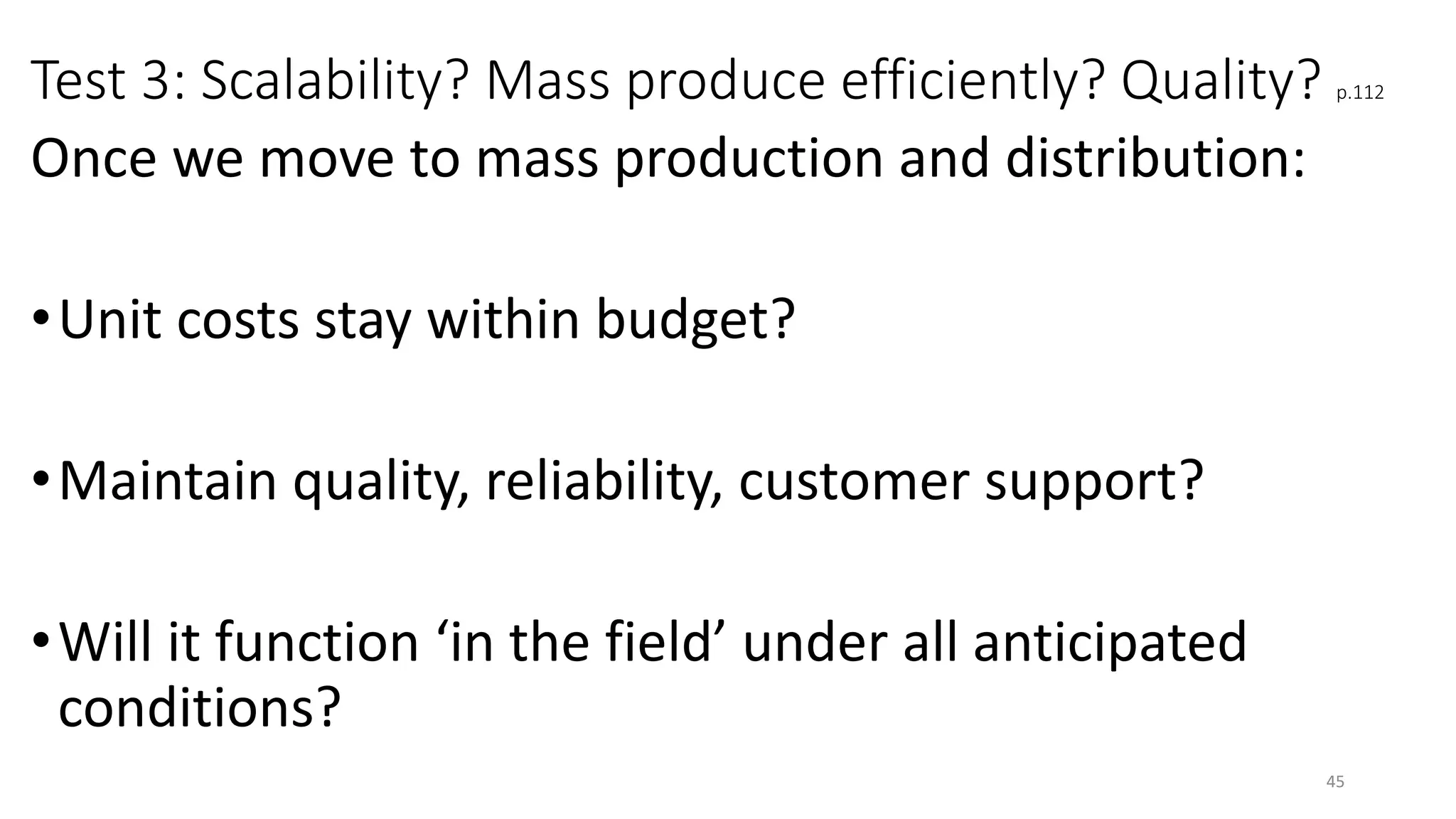

Test 3: Scalability? Mass produce efficiently? Quality? p.112
Once we move to mass production and distribution:
•Unit costs stay within budget?
•Maintain quality, reliability, customer support?
•Will it function ‘in the field’ under all anticipated
conditions?
45

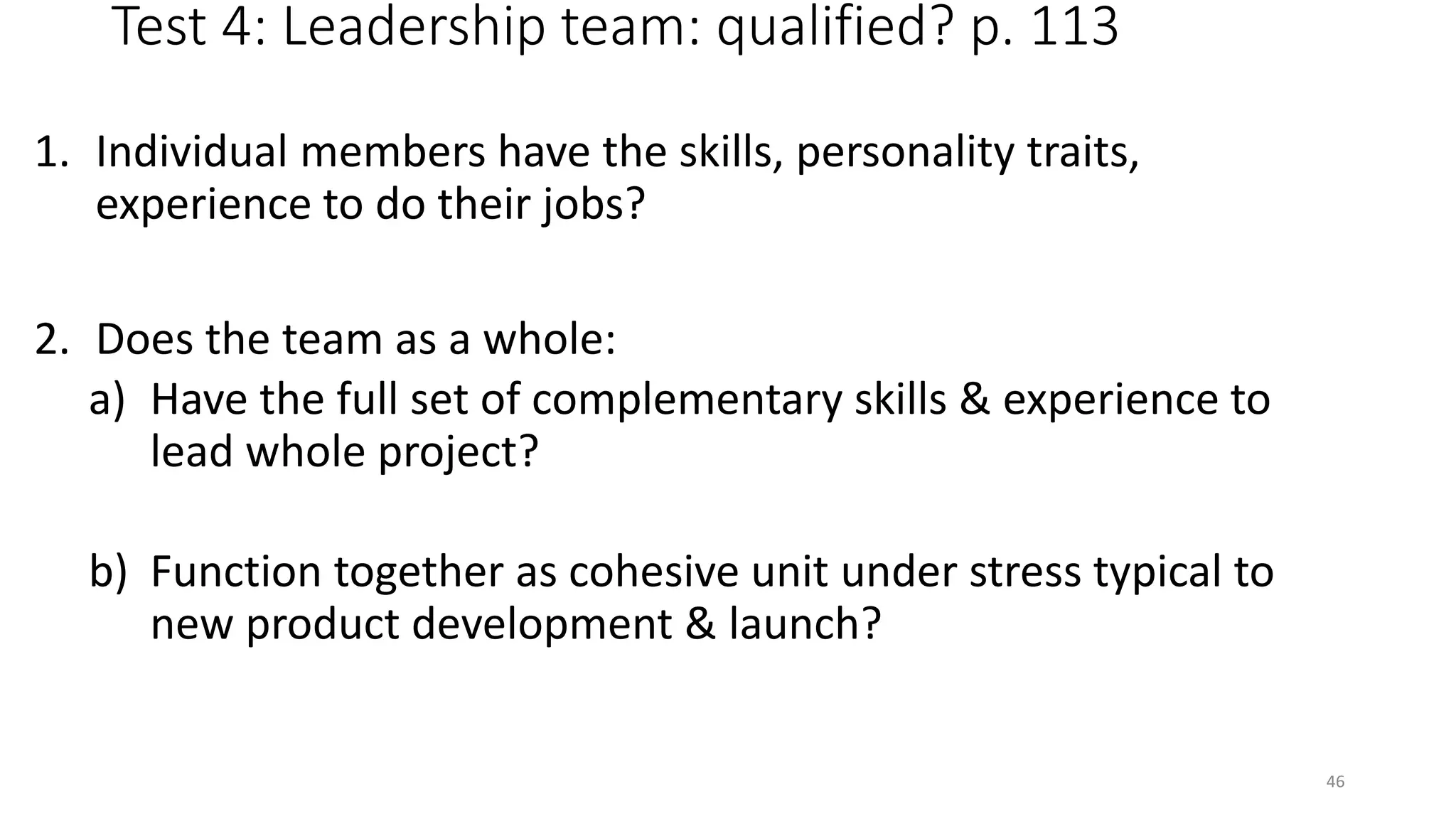

Test 4: Leadership team: qualified? p. 113
1. Individual members have the skills, personality traits,
experience to do their jobs?
2. Does the team as a whole:
a) Have the full set of complementary skills & experience to
lead whole project?
b) Function together as cohesive unit under stress typical to
new product development & launch?
46
Got the right team to succeed?
47
Test 5: Intellectual property (IP): Control? Rights? p.114
Have control or rights to all relevant IP via one or more
of the following:
1. For IP we created: protect & control rights + access
via :
a) Blocking strategies to prevent others from legally.
b) “Run fast”: simply plan on innovating faster and
staying ahead of competition. (cont’d next slide)
48
Test 5: Intellectual property (IP) p.114 (cont’d)
1. For IP we created: protect & control rights + access via
(cont’d):
c) Clear, documented efforts to hide the IP as a “trade
secret.”
d) Form joint ventures (JVs) with other entities to share IP.
2. For IP we don’t control, license or purchase relevant IP
rights for relevant jurisdictions (where will sell it)
49

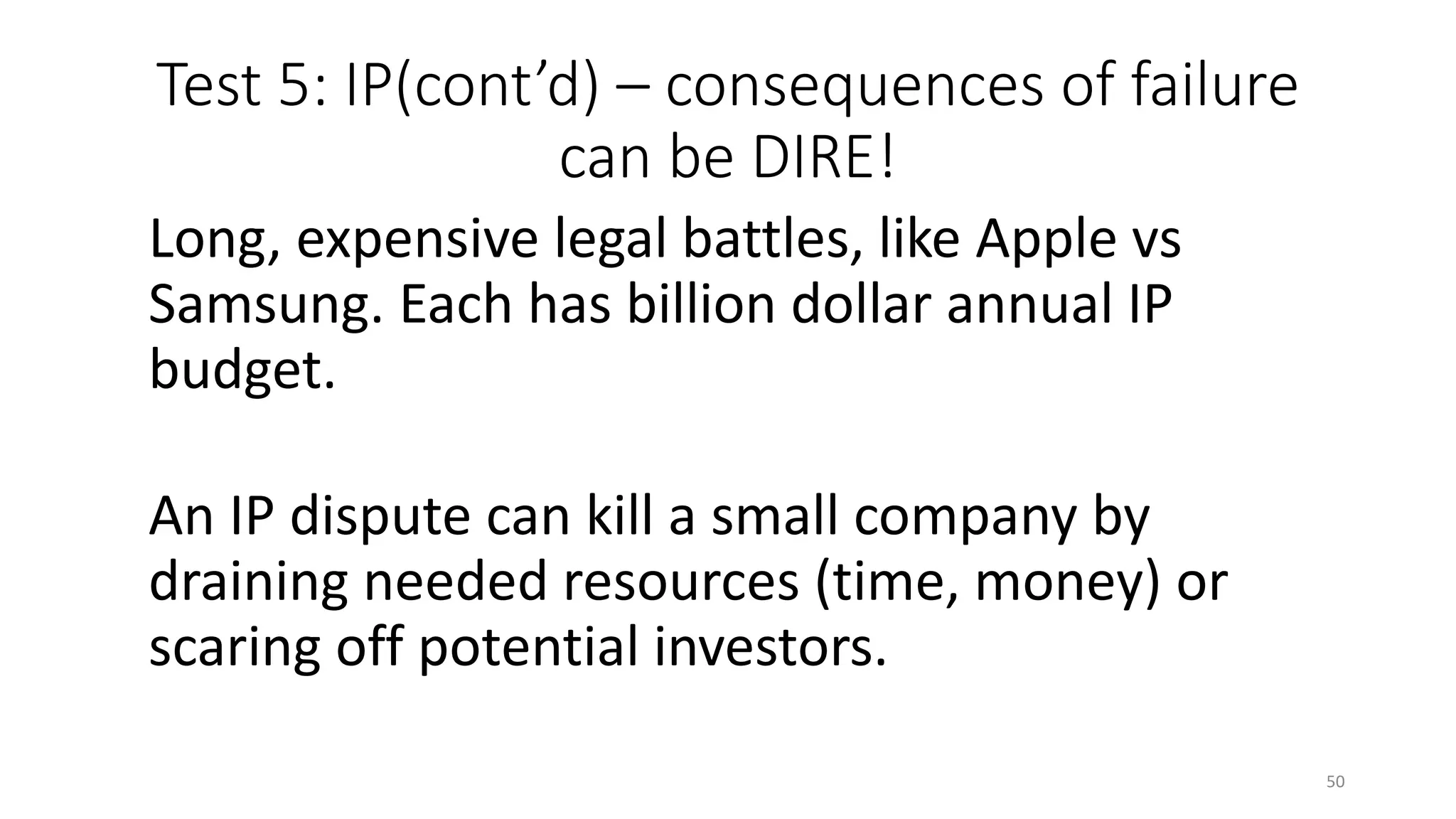

Test 5: IP(cont’d) – consequences of failure
can be DIRE!
Long, expensive legal battles, like Apple vs
Samsung. Each has billion dollar annual IP
budget.
An IP dispute can kill a small company by
draining needed resources (time, money) or
scaring off potential investors.
50
No regrets! – secure your IP
51
Test 6: Financial return on investment
52
Test 6: Good ROI?
Minimum ROI required?: For-profit enterprises
usually require a minimum return on investment
(ROI) for a given level of risk.
Consider Risk Premium: The higher the risk, the
higher the expected ROI to justify the investment.
53
Beware of excessive focus on high rates of return
54
Test 7: Social responsibility: environmental, social
& community outcomes OK? p. 115
1. Environmental: impact is neutral or positive.
2. Social & community: If material threat of vocal
resistance from groups hurt by the project, consider
steps to minimize/eliminate threat.
3. Related issues: legal compliance, reputation, “5 P’s”
people planet, public probity, and profit outcomes.
55
Test 8: Fit with organizational strategy – Introduction
p. 115
“In-house” commercialization of valuable IP isn’t always the best option.
Reasons to sell, license, or share technology (via JV) include:
1. Lack internal resources/capabilities: Lack funds, channels, expertise.
2. Lack strategic fit: if invention is unrelated to the core business, in-house
commercialization risks diluting or losing focus on existing mainstream
business lines.
56
Test 8: Fit with organizational strategy - Bank Example (1) p. 115
A large bank produced a certain software innovation that service and had
potential well beyond that bank’s applications and industry.
Two basic options:
1. retain the IP and:
a.Keep exclusive use as a trade secret, to create a competitive advantage
b.commercialize it internally, sell as a product/service, as a separate profit
center
2. Sell or license it to a third party for development and distribution
57
Test 8: Fit with organizational strategy - Bank
Example (2): Cost/benefit vs. strategic
considerations p. 115
Cost/benefit per 8 tests: A first consideration - how can we best
create revenue and profit from it? How ensure it passes these 8
tests?
Overall business strategy concerns: However, there are multiple
strategic issues that are likely to be at least as important.
Strategic questions include….
58

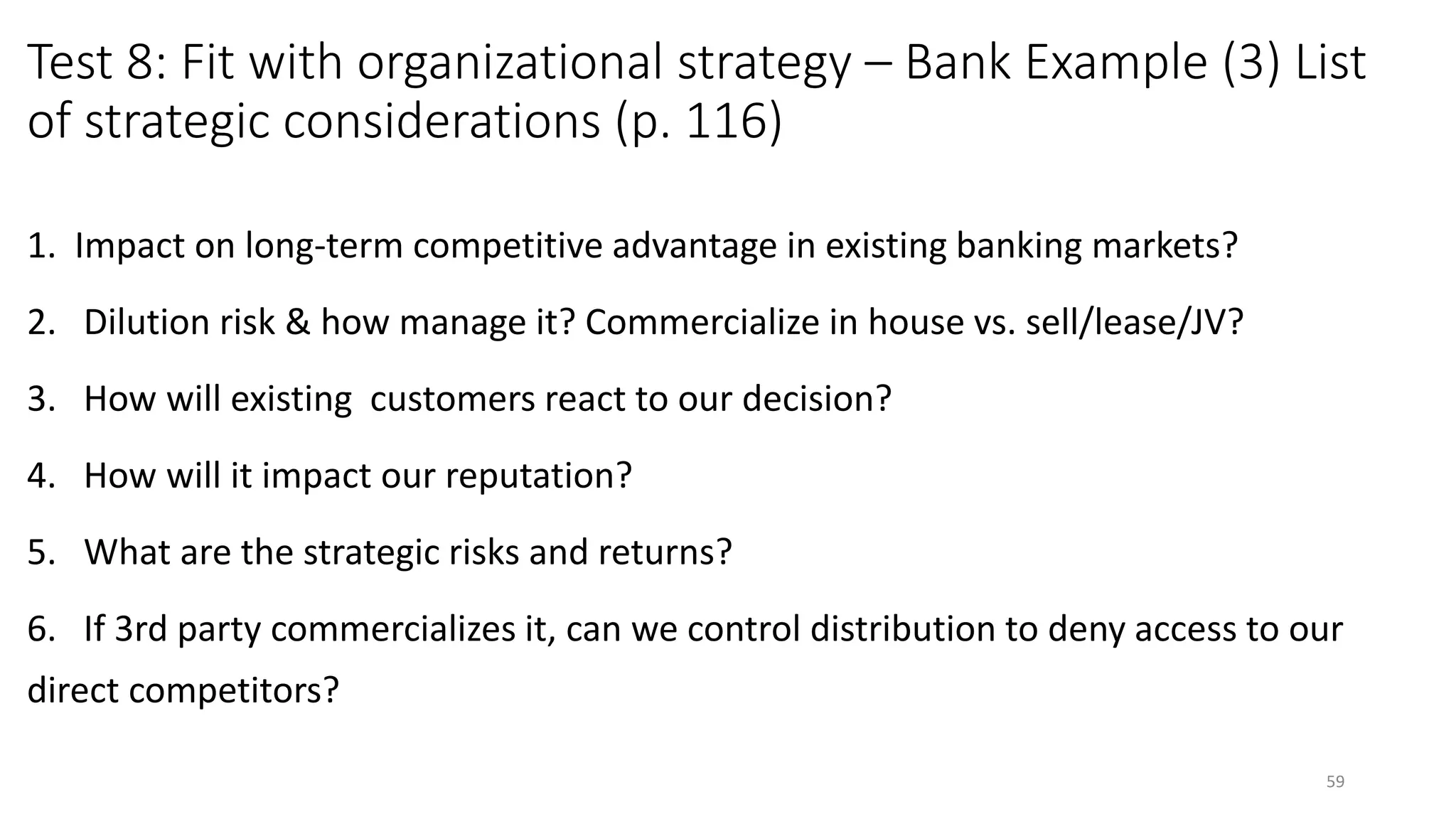

Test 8: Fit with organizational strategy – Bank Example (3) List
of strategic considerations (p. 116)
1. Impact on long-term competitive advantage in existing banking markets?
2. Dilution risk & how manage it? Commercialize in house vs. sell/lease/JV?
3. How will existing customers react to our decision?
4. How will it impact our reputation?
5. What are the strategic risks and returns?
6. If 3rd party commercializes it, can we control distribution to deny access to our
direct competitors?
59
Test 8: Fit with organizational strategy - Bank
Example (4) Their decision (p. 117)
Avoided dilution risk: spun off the software to a 3rd party IT business
capable of marketing it, under its own brand and license.
Accepted risk of losing potential long term new revenue stream and
competitive advantage. Denying access to competitors impossible.
The bank negotiated a three-year lead time before buyer could sell the
software to competitors.
60

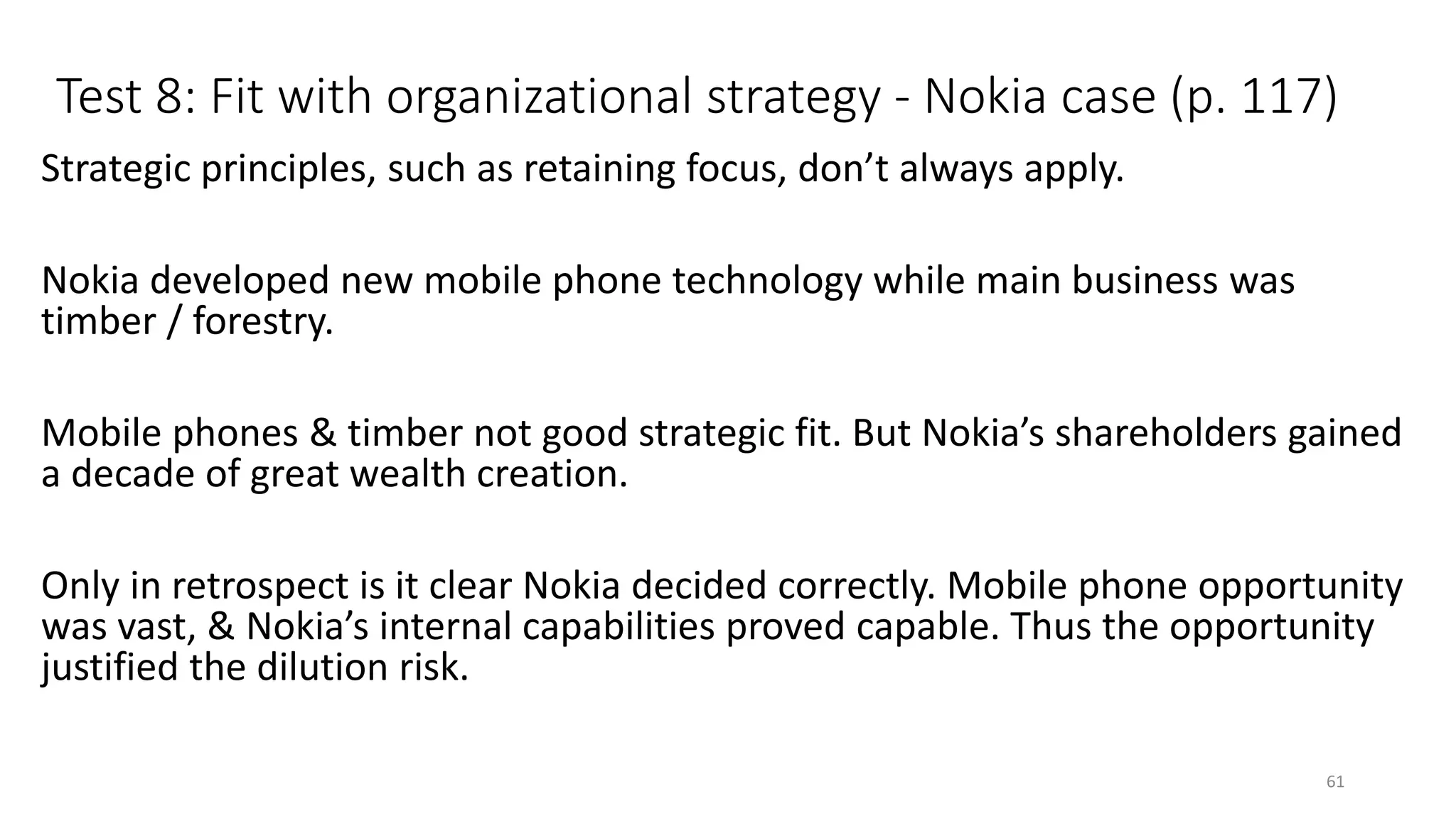

Test 8: Fit with organizational strategy - Nokia case (p. 117)
Strategic principles, such as retaining focus, don’t always apply.
Nokia developed new mobile phone technology while main business was
timber / forestry.
Mobile phones & timber not good strategic fit. But Nokia’s shareholders gained
a decade of great wealth creation.
Only in retrospect is it clear Nokia decided correctly. Mobile phone opportunity
was vast, & Nokia’s internal capabilities proved capable. Thus the opportunity
justified the dilution risk.
61
Using these 8 tests p. 117
These 8 tests are filters for selecting projects with best cost/benefit
relative to risk of underperformance or failure.
Apply them throughout the NPD process, not just at the earlier stages
of the fuzzy front end. Indeed, as project advances, have more
information and evidence, so can apply the tests more accurately.
They apply to organizations of all sizes: albeit in different ways. For
example, test complexity typically grows with size of the company.
62
PART 3: THE PORTFOLIO OF INNOVATION
STRATEGIES
63

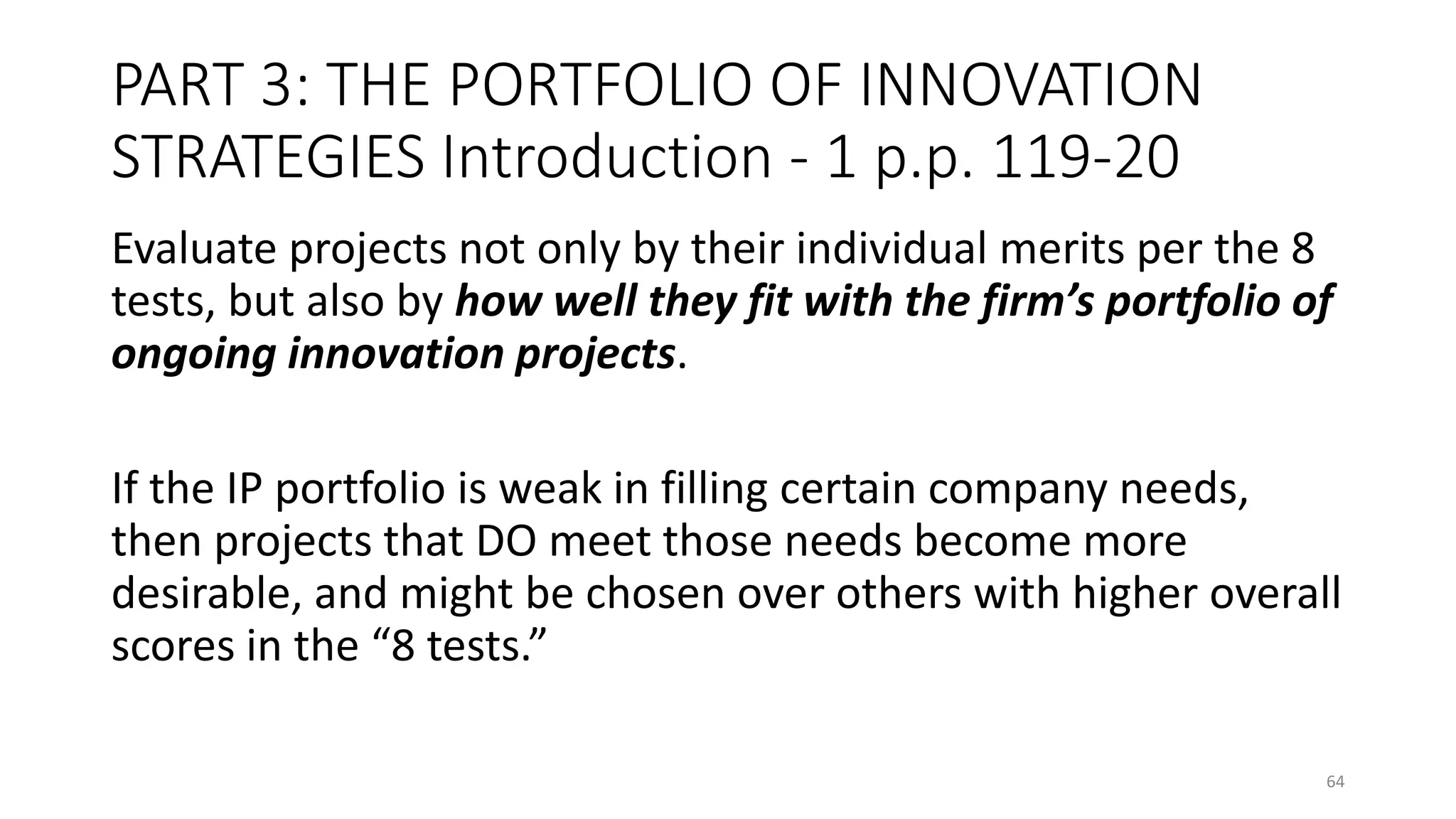

PART 3: THE PORTFOLIO OF INNOVATION
STRATEGIES Introduction - 1 p.p. 119-20
Evaluate projects not only by their individual merits per the 8
tests, but also by how well they fit with the firm’s portfolio of
ongoing innovation projects.
If the IP portfolio is weak in filling certain company needs,
then projects that DO meet those needs become more
desirable, and might be chosen over others with higher overall
scores in the “8 tests.”
64
PART 3: THE PORTFOLIO OF INNOVATION
STRATEGIES Introduction - 2 p. 120
Just like a football team needs 11 players with different skills at
different positions, so too the IP portfolio needs projects that fill
different company needs.
Thus at times, a team might choose a lesser player over a better one, if
that player best fills a certain skill gap on the field.
Similarly, an organization’s “Go/No go” decision might depend more on
what gaps it needs to fill than on which project ranks highest in overall
individual merit per the “8 tests.”
65
Example: The need for steady earnings
Organizations have many goals, like long-term survival & competitiveness, and
meeting various compliance and performance measures.
For example, companies prefer steady earnings, ideally steadily rising earnings.
Why?
Investors hate risk. They interpret steady performance to imply lower risk.
They’ll pay more for shares in these lower risk businesses, and pay their
managers better.
Thus (all else being equal) firms prefer steady over volatile earnings and other
measures of financial performance.
66

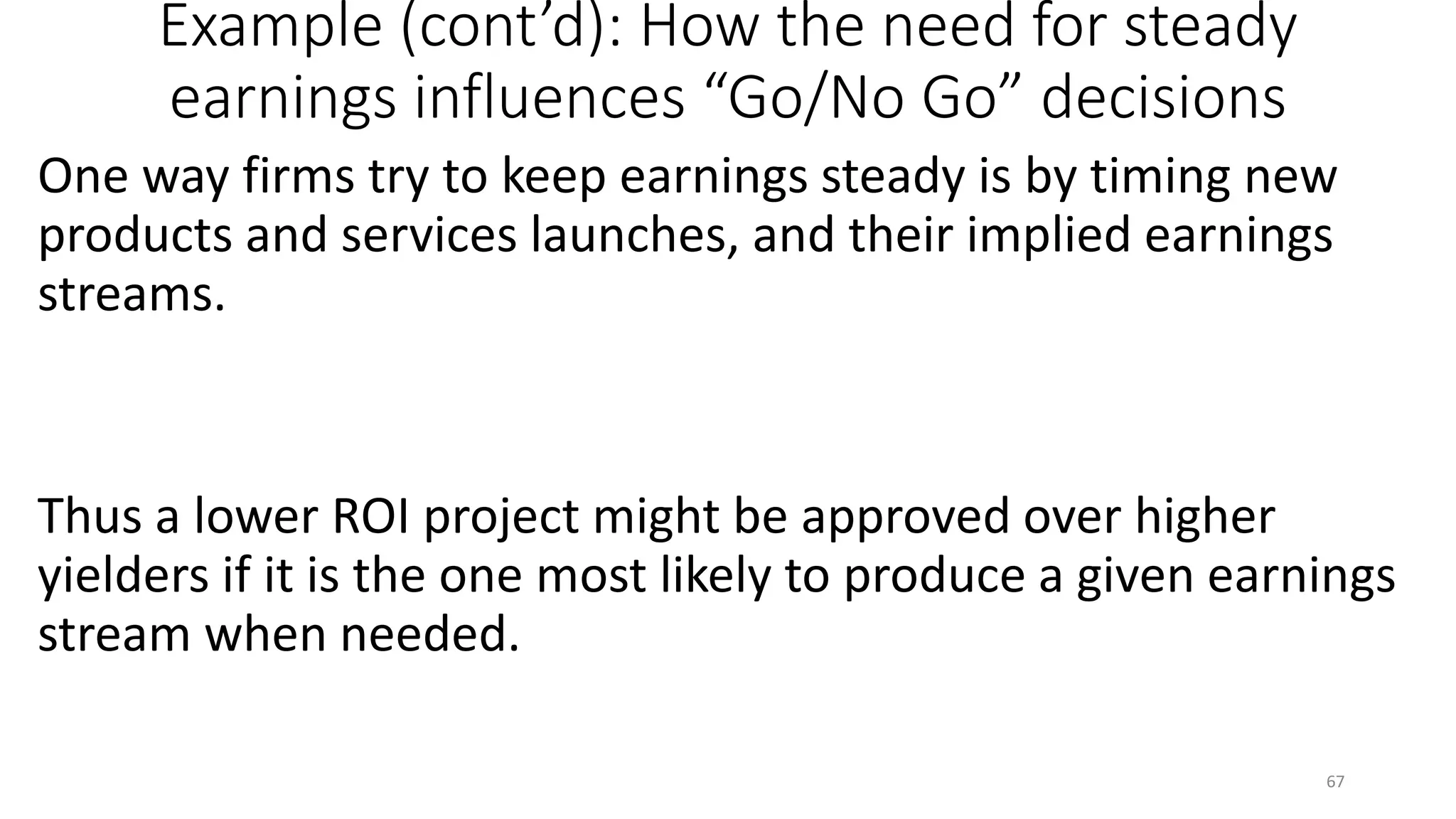

Example (cont’d): How the need for steady
earnings influences “Go/No Go” decisions
One way firms try to keep earnings steady is by timing new
products and services launches, and their implied earnings
streams.
Thus a lower ROI project might be approved over higher
yielders if it is the one most likely to produce a given earnings
stream when needed.
67

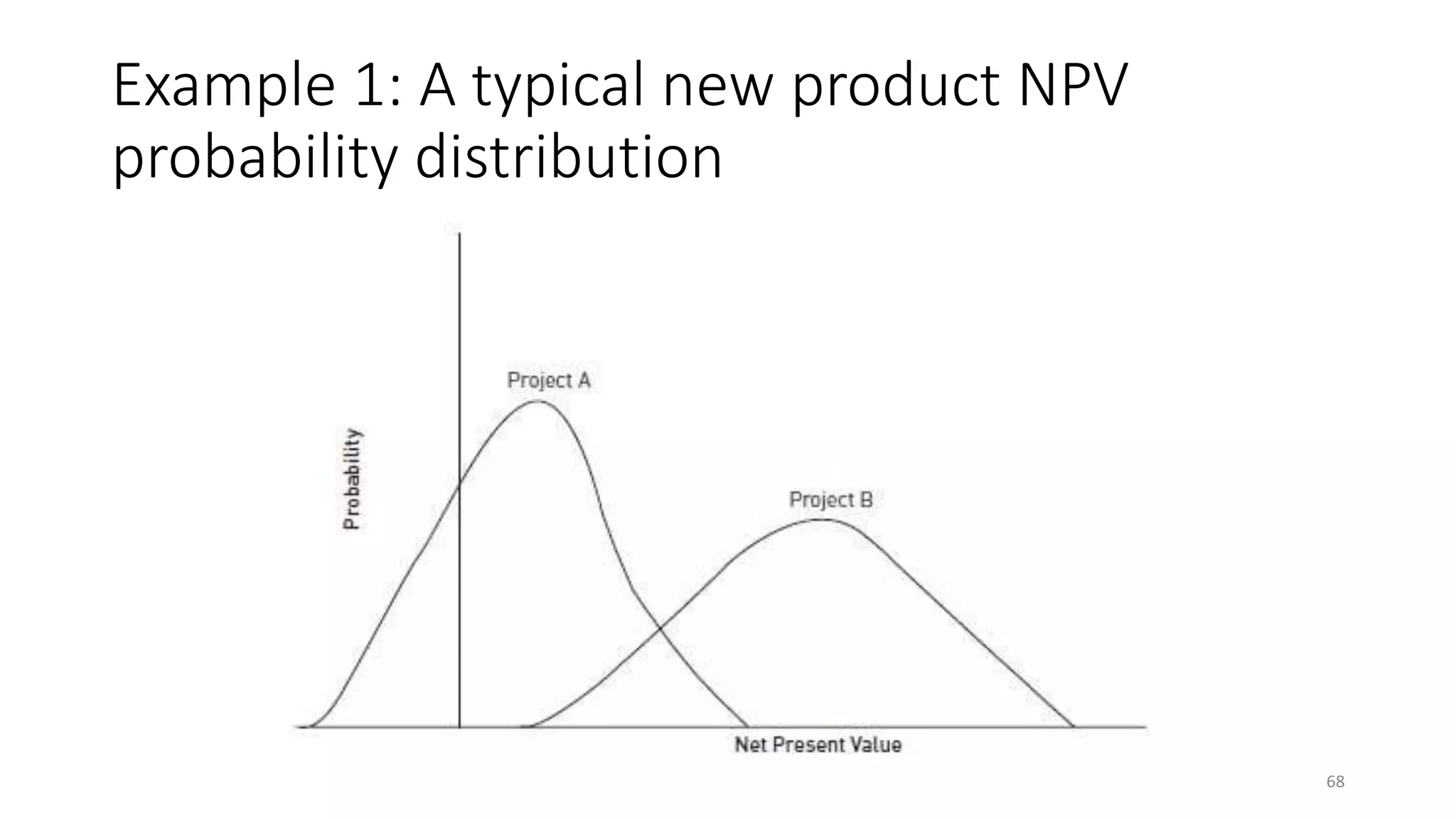

Example 1: A typical new product NPV
probability distribution
68
Example 1: Re-evaluating a project’s estimated NPV
throughout the NPD process
Throughout the NPD process, we repeatedly apply the 8 tests to re-evaluate
project viability and its probable net present value (NPV).
During the development phase of each project, its NPV probability distribution
would shift based on new information. For example:
• solving a technical problem might increase estimated NPV, thus shifting the
NPV probability distribution to the right
• doing some market research would likely move the distribution to the
left or right, depending on whether the research indicated a higher or
lower chance of success
69
Example 1: Re-evaluating a project’s estimated
NPV throughout the NPD process (cont’d)
So for each new innovation initiative we can formulate a dynamic
approach to probabilistic value creation on a project-by-project basis.
The next illustration adds timing estimates of that revenue stream, and for
an entire portfolio of innovations.
Thus it illustrates how firms would be identify projects most likely to
produce a given earnings stream when needed to keep revenues steady,
and ideally, steadily rising.
70

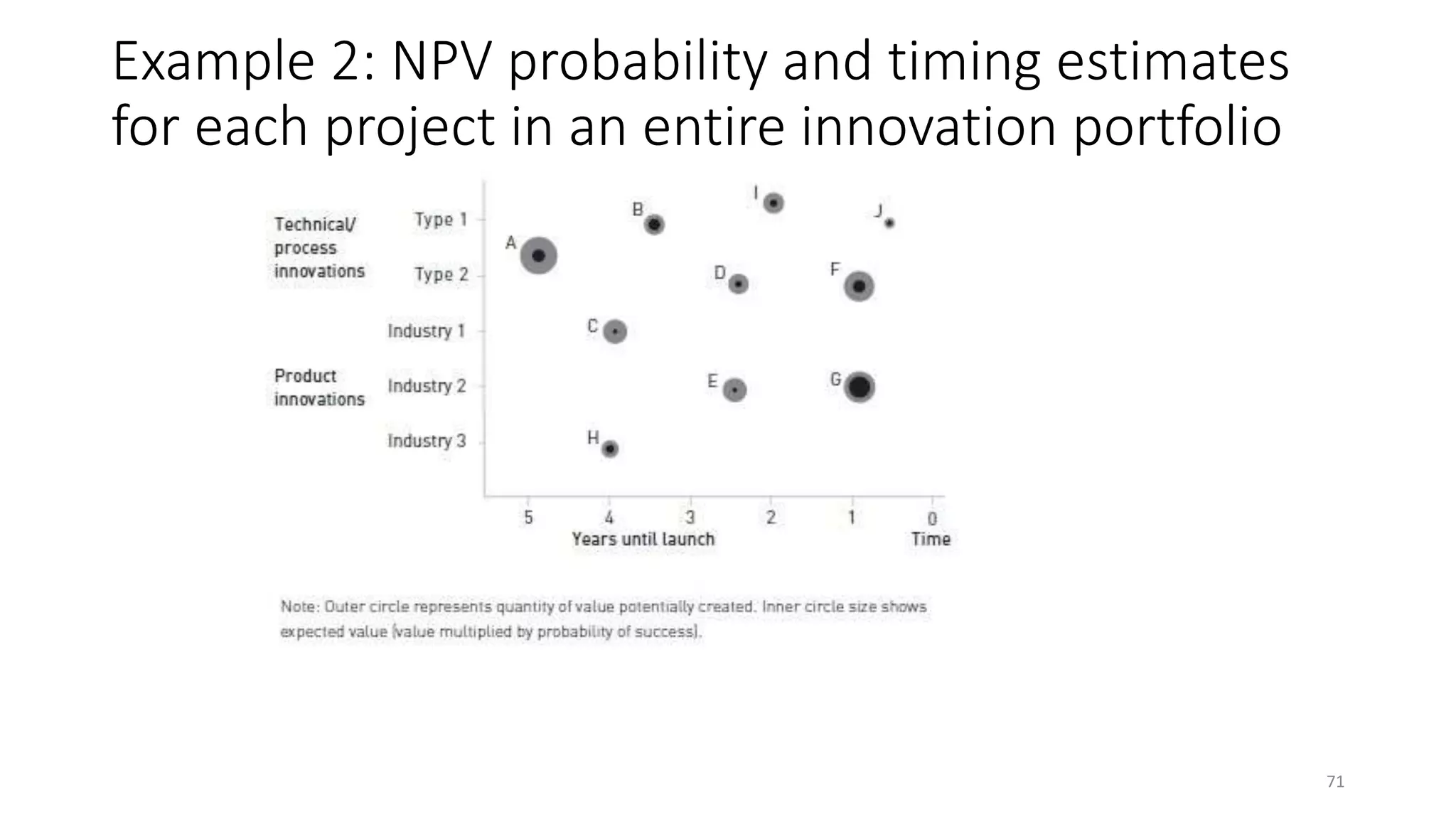

Example 2: NPV probability and timing estimates
for each project in an entire innovation portfolio
71
Example 2: Estimating probable value AND its
timing for each project in an innovation portfolio
Here’s another approach to measuring and managing the portfolio of
innovations: showing both estimated project value AND its timing.
Expected value of success = (a single probability of success estimate) x
(estimated value created upon success)
Value = revenue, or profit estimates (or both).
This approach allows firms to identify and select projects that will
contribute value when needed to keep earnings steady and/or rising.
72
Example 2: Explanation & comments
Outer circle size shows project profitability, the inner circle showing
probability weighted against expected profit
Horizontal axis shows timing of first revenue expectation (launch date).
Vertical axis shows the divisional split of these products or another
categorization.
Illustration 2 communicates a picture of both:
• Potential and likely value of each project
• timing of that value – allowing selection based on value timing needs
73
Summary Part 3: Portfolio of Innovation Strategies
Evaluate projects not just on their individual merits, but also on how well
they fit with the firm’s overall goals.
For example, a firm might select a project ahead of others that score higher
on the 8 tests because it:
• Delivers a given value stream when needed to keep certain financial
metrics steady or steadily rising
• Provides diversification into a certain product category or emerging
technology in which the firm wants a presence
74
LECTURE SUMMARY
MANAGING THE INNOVATION PORTFOLIO
AND PROJECTS
75
PART 1: INITIATING NEW-STREAM
INNOVATION PROJECTS p.98
New Product Development p.98
• Do the right project: The funneling process p. 99
• Do the project right: Methodology flowchart p.100
• Detailed description of the methodology for simulation of the fuzzy front end
stage p.101
• Stage 1: Discover
• Stage 2: Definition
• Stage 3: Design p.102
• Stage 4: Development
• Stage 5: Delivery
76
PART 2: MANAGING AND EVALUATING INDIVIDUAL
INNOVATION IDEAS THROUGH THE PIPELINE p.107
2A: Use Project Management Philosophy, Tools, And
Techniques p. 108
4 key steps to applying project management to innovation
•Definition: Define the project
•Division: Divide or break down project into steps
•Sequencing: Plan sequence of tasks
•Budgeting: Create budget and resource plan
77
PART 2: MANAGING AND EVALUATING INDIVIDUAL
INNOVATION IDEAS THROUGH THE PIPELINE p.107 (cont’d)
2B: 8 Tests To Identify “High Potential” Ideas For Innovation
Investment p109
• Test 1: Valuable benefits test / valuable benefits? p. 110
• Test 2: Marketing test: Got channel and demand? p. 111
• Test 3: Scale up/ Scalable? p. 112
• Test 4: Leadership team p. 113
• Test 5: Intellectual property p. 114
• Test 6: Financial return on investment / ROI
• Test 7: Corporate social responsibility
• Test 8: Fit with organizational strategy p. 115
78
PART 3: THE PORTFOLIO OF INNOVATION
STRATEGIES
Evaluate projects not just on their individual merits, but also
on how well they fit with the firm’s overall goals.
Projects that might have lower overall scores on the 8 tests in
Part 2 might still merit selection if they fill a gap or weakness
in the innovation portfolio’s ability to meet those goals.
79
QUESTIONS?
THANK YOU
80
SPECIAL SUPPLEMENTARY TOPICS
--INNOVATION AND ENTEREPRENEURSHIP
THOUGHT LEADERSHIP
--CASE STUDIES
81
Case Study: Innovation the Lego way p. 105
Lego goes from near bankruptcy to financial health, robust growth.
How? By building capability for systematic innovation that produces wide
range of successful new products &product lines.
“Executive Governance Group” means innovation culture from the top down,
lead by senior management
Lego divided operations into 8 areas, seeks to drive innovation in all, thus
fuel continued growth.
82
TOTAL INNOVATION p. 106 (Nagil & Tuff, 2012)
For every project portfolio, allocate a certain proportion of projects &
resources to these types of products and innovation levels:
• Core: incremental changes to existing offerings (Mercedes Benz
“AMG” or VW “GTI,” sportier versions of existing models)
• Adjacent: expanding into related products, such as moving along the
value chain (e.g. from Apple products to Apple stores).
• Transformational: innovating to create new products for new markets
(Sony Walkman, or Tesla’s high-performance pure electric vehicle)
83
POSITIONS IN MARKETS AND PORTFOLIOS: TACTICS TO
POSITION INNOVATIONS p. 107 Schmidt and Rhee (2014)
• A low-end approach: if performance is weak, lower price point to draw price-
conscious consumer (Formula 1 hotels, Air Asia).
• A high-end approach: if proven high performance, high price (Porsche Cayenne)
• A niche-features approach: if has specialized benefits highly valued by small market
segment, high price if they’re affluent (memorabilia)
• Other examples: new-attributes high-end, radical innovation, etc.
• Choose one, or a portfolio of approaches that mixes positioning and price points.
84

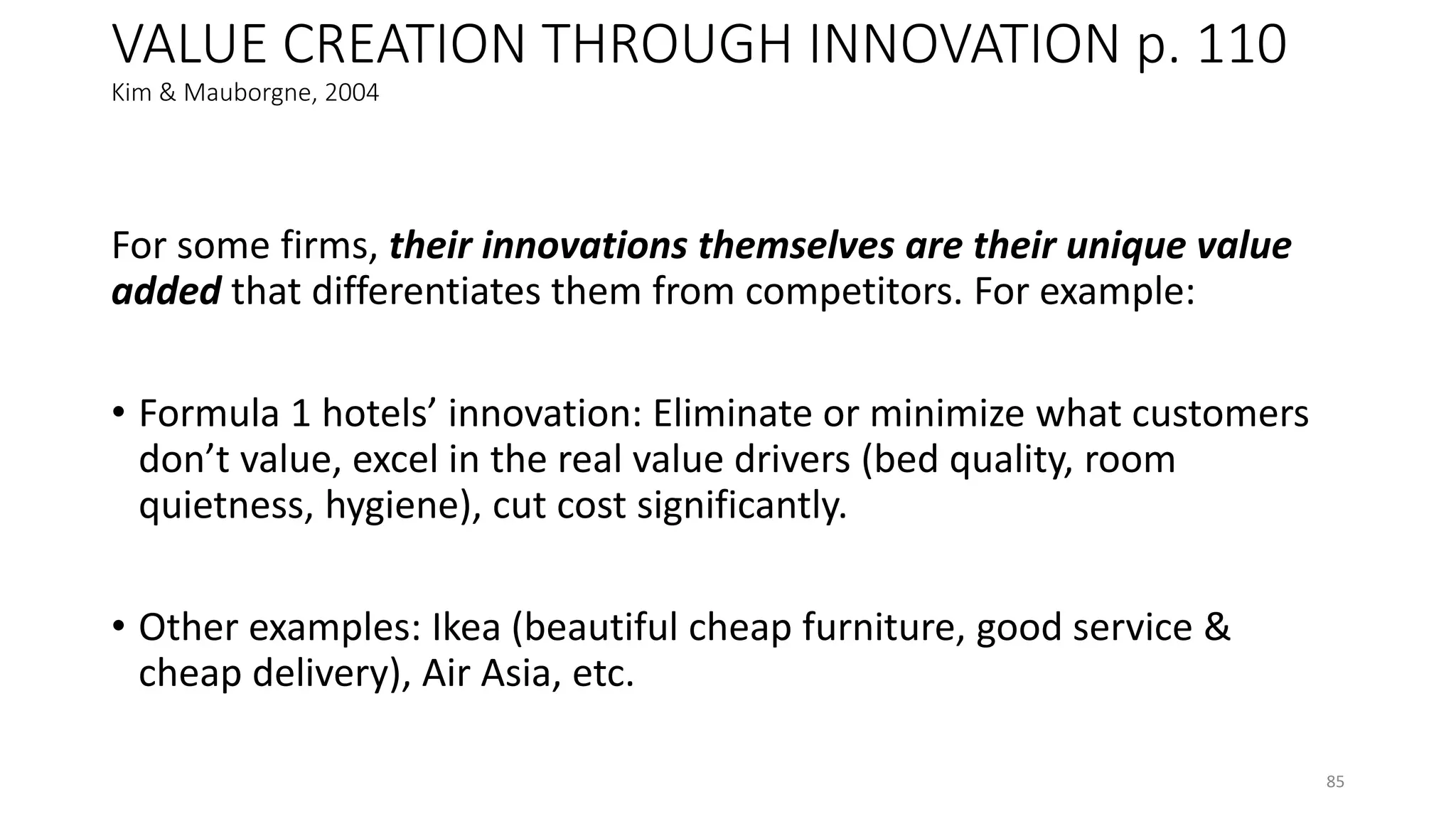

VALUE CREATION THROUGH INNOVATION p. 110
Kim & Mauborgne, 2004
For some firms, their innovations themselves are their unique value
added that differentiates them from competitors. For example:
• Formula 1 hotels’ innovation: Eliminate or minimize what customers
don’t value, excel in the real value drivers (bed quality, room
quietness, hygiene), cut cost significantly.
• Other examples: Ikea (beautiful cheap furniture, good service &
cheap delivery), Air Asia, etc.
85
CASE STUDY: NEW ZEALAND NATURAL: MARKET-DRIVEN
ICE-CREAM INNOVATION p. 111
Struggling ice cream chain becomes successful via innovation.
Key insight & innovation: taste preferences vary across regions ,
depending on culture, diet, so match flavors to local tastes.
• Chinese eat few dairy products, so they prefer less sweet flavors, like
green tea flavor, which masks a strong dairy presence
• In contrast, US consumers eat more dairy products and sweets, like
‘cookies and cream’ flavor.
86
WORLD’S BEST INNOVATION PRACTICES? P&G –
“AGILE GIANT” p. 113 Brown & Anthony, 2011
• Focus on what consumers want: make it simpler, more convenient, cheaper.
• Strategic portfolio mindset: disciplined active measuring & managing projects, ‘by
the numbers’ & strategically (contribution to overall P&G needs/priorities).
• Trial & error
• Big bets based only after successful small bets provide validation
• Invests in resources needed to succeed + education, interdisciplinary idea exchange
87
RADICAL AND INCREMENTAL INNOVATION p. 117
Treacy, 2004
Innovation portfolios need to strike a balance between the proportion of radical
and incremental innovations.
Incremental innovations help maintain revenues, market share, and customer
satisfaction while the next disruptive innovation remains under development.
Failing to invest in higher risk radical innovations carries its own dangers: risk of
missing the next technology that could threaten your core business, or of missing
the next chance for outsized value creation and growth.
88
MATCH THE APPROACH TO THE MARKET DEVELOPMENT
p. 118 Moore, 2004
Overview:
Moore categorizes innovations into 7 distinct types or stages
He asserts that:
Specific types of innovations tend to work best in at certain stages of a
market’s development or maturity
Therefore your innovation strategy should be to first understand what
stage of development your market has reached, then focus resources
on the kinds of innovation that best suit that kind of market.
Now look at details:….
89
MATCH THE APPROACH TO THE MARKET DEVELOPMENT

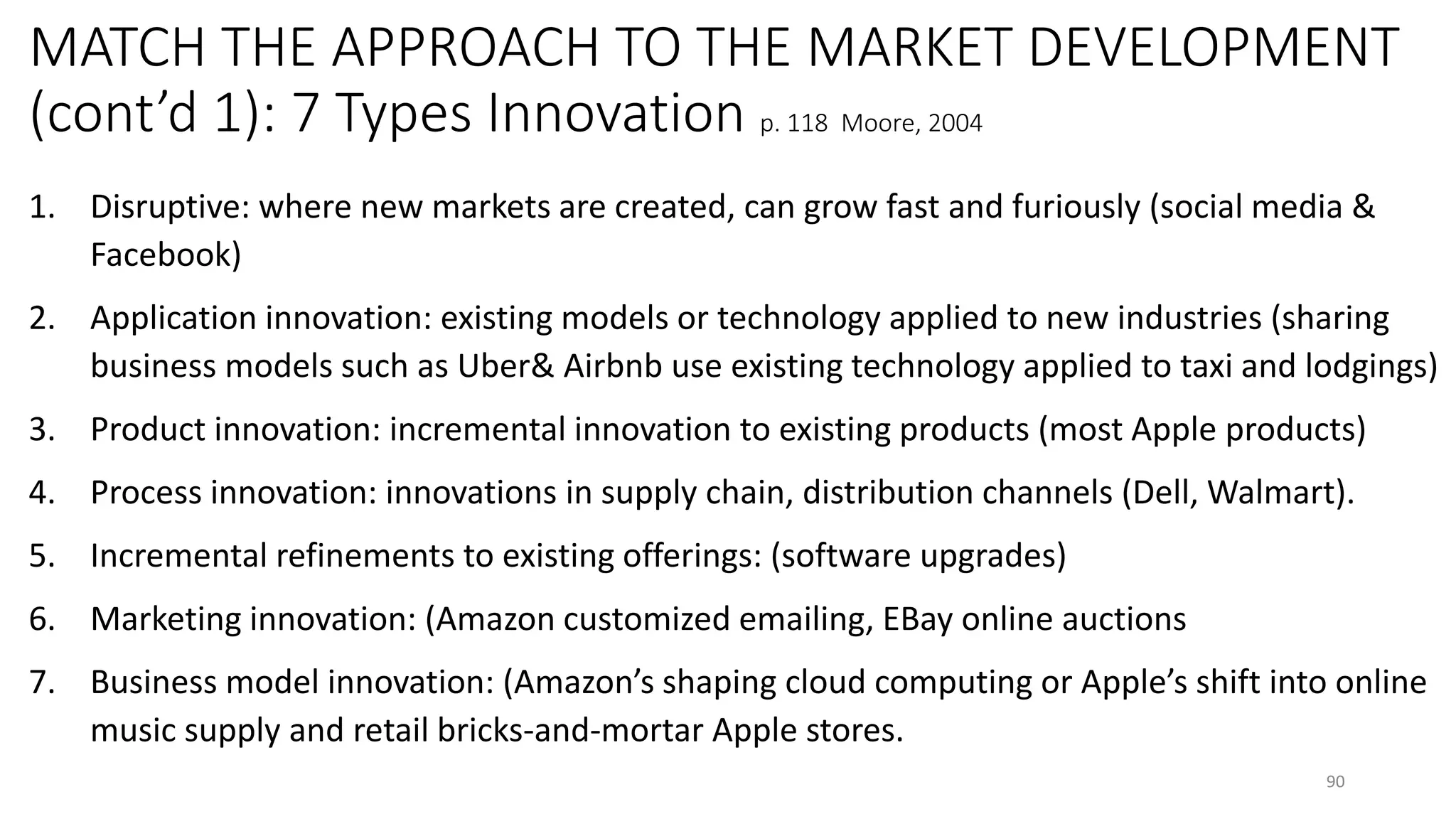

(cont’d 1): 7 Types Innovation p. 118 Moore, 2004
1. Disruptive: where new markets are created, can grow fast and furiously (social media &
Facebook)
2. Application innovation: existing models or technology applied to new industries (sharing
business models such as Uber& Airbnb use existing technology applied to taxi and lodgings)
3. Product innovation: incremental innovation to existing products (most Apple products)
4. Process innovation: innovations in supply chain, distribution channels (Dell, Walmart).
5. Incremental refinements to existing offerings: (software upgrades)
6. Marketing innovation: (Amazon customized emailing, EBay online auctions
7. Business model innovation: (Amazon’s shaping cloud computing or Apple’s shift into online
music supply and retail bricks-and-mortar Apple stores.
90
MATCH THE APPROACH TO THE MARKET DEVELOPMENT

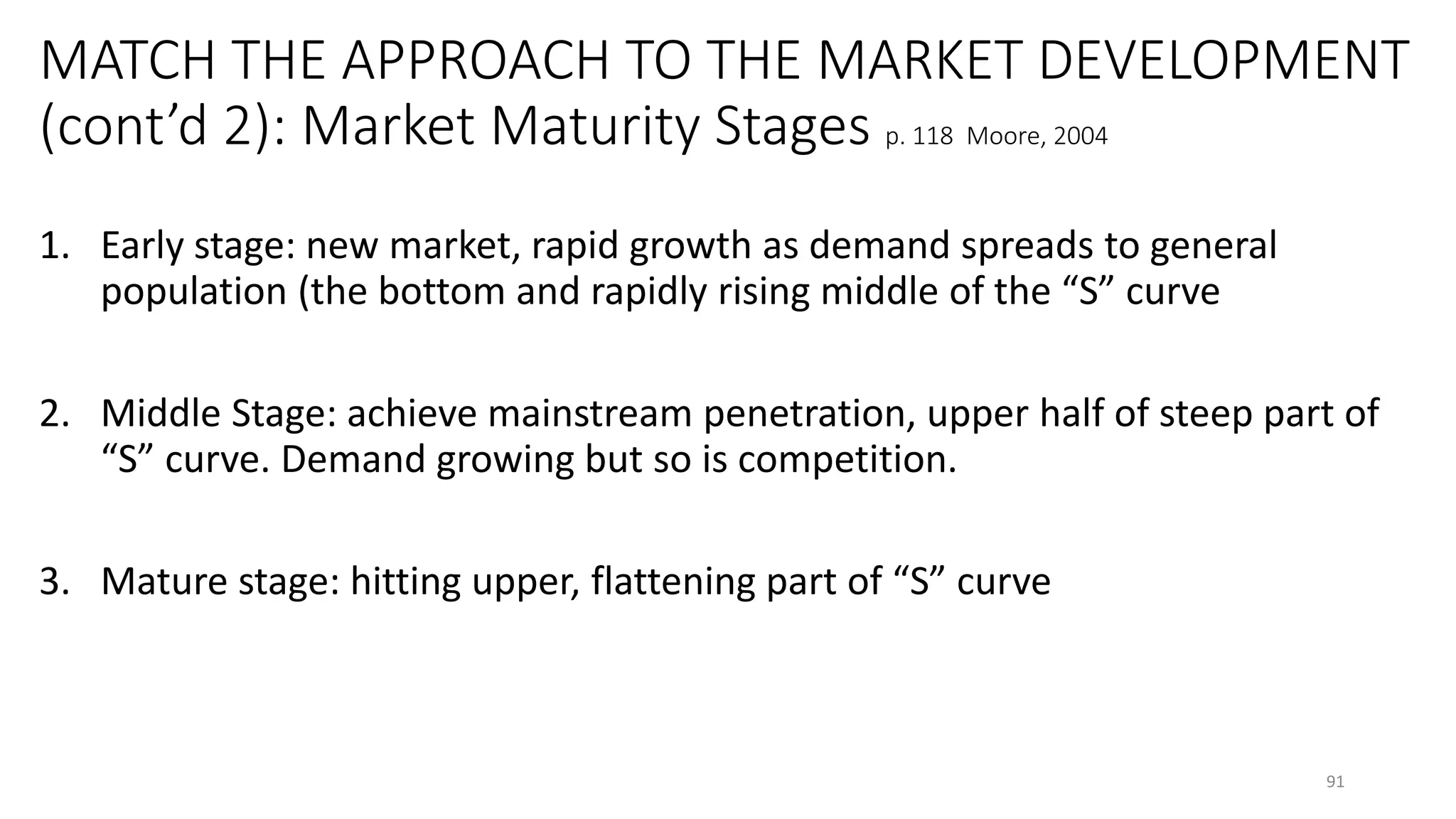

(cont’d 2): Market Maturity Stages p. 118 Moore, 2004
1. Early stage: new market, rapid growth as demand spreads to general
population (the bottom and rapidly rising middle of the “S” curve
2. Middle Stage: achieve mainstream penetration, upper half of steep part of
“S” curve. Demand growing but so is competition.
3. Mature stage: hitting upper, flattening part of “S” curve
91
MATCH THE APPROACH TO THE MARKET
DEVELOPMENT (cont’d 3): p. 118 Moore, 2004
• Innovation types 1-2 most effective in early stage
markets
• Types 3-4 best fit for middle stage markets
• Types 5-7 for late stage
92

Managing the innovation portfolio and projects sl deck v5 slideshare version

  • 1.
    MANAGING THE INNOVATION PORTFOLIO ANDPROJECTS Cliff Wachtel Project Management Lecture Presentation 1
  • 2.
    INTRODUCTION PART 1: INITIATINGNEW-STREAM INNOVATION PROJECTS PART 2: MANAGING & EVALUATING INDIVIDUAL INNOVATION IDEAS THROUGH THE PIPELINE P.107 PART 3: THE PORTFOLIO OF INNOVATION STRATEGIES 2
  • 3.
    PART 1: INITIATINGNEW-STREAM INNOVATION PROJECTS New Product Development (henceforth “NPD”) -3 parts p.98 • Do the right project: The funneling process p. 99 • Do the project right: Methodology flowchart p. 100 • Detailed description of the methodology for simulation of the fuzzy front end stage p.101 3
  • 4.
    PART 2: MANAGINGAND EVALUATING INDIVIDUAL INNOVATION IDEAS THROUGH THE PIPELINE P.107 Part 2A: Use Project Management Philosophy, Tools, And Techniques p. 108 Part 2B: 8 Tests To Identify “High Potential” Ideas For Innovation Investment p109 4
  • 5.
    PART 3: THEPORTFOLIO OF INNOVATION STRATEGIES Criteria and tools for selecting projects for company’s innovation portfolio. Sometimes choose lesser projects per “8 tests” because they best fill gaps in the firm’s innovation portfolio 5
  • 6.
    PART 1: INITIATINGNEW-STREAM INNOVATION PROJECTS p.98 6
  • 7.
  • 8.
    New Product Development(NPD) – The “Fuzzy Front End” – 3 Parts p.98 1. Do the right project: The funneling process (selection) p. 99 2. Do the project right: Methodology flowchart (execution - flowchart) p.100 3. Detailed description of methodology for simulation of the fuzzy front end stage (execution – steps detailed) p. 101 8
  • 9.
    Part 1, Section1. Do the right project: The funneling process (“fuzzy front end”) p. 99 Source: Katz, 2011,available at http://www.innovationexcellence.com/blog/2011/11/29/ rethinking-the-product-development-funnel 9
  • 10.
    1a. Evaluate choicesets by using computer based modeling p. 100 Computer simulations of the NPD process help reduce the uncertainty or “fuzz” For each alternative design (and implied performance levels, time and resources needed), it can model, (show us) estimates of various metrics like…. 10
  • 11.
    1b. For example,shows resource information, like need vs. availability, for a given “mode” or way of doing a given step in production process 11
  • 12.
    1b. (cont’d): Hasresource management information, ability to add/subtract resources, and see effects of those changes 12
  • 13.
    1c. For example,shows duration of activities, dependencies – which must happen in sequence or can occur in parallel 13
  • 14.
    1d. Simulation showscost/benefit tradeoffs for different “modes”, or for different features For example: • Mode choice: “re-use existing parts components” versus “new development of components” • Feature choice: heavier car door offers the customer a feeling of greater higher quality and safety, but at the expense of fuel economy and price. 14
  • 15.
    1e. Computer simulation/modelingimproves odds of success on the fuzzy (uncertain) front end • Interactively experience effects of any given change or option. • Thus greatly reduces uncertainty by providing a formal method of understanding the trade-offs and identifying the “best” solution • “Best”? For whom? 15
  • 16.
    Part 1, Section2. Do the project right: Methodology flowchart p. 100 16
  • 17.
    Part 1 Section2a. Do the project right: Methodology funnel flowchart introduction p. 100 • The fuzzy front end: where we do market research, get validation of value propositions and product-market fit. • Well-defined projects take less time and money, operate better. • We use a well-planned and structured process. • The above illustration summarizes it. Let’s elaborate on each step. 17
  • 18.
    Part 1, Section3: Detailed description of methodology for simulation of fuzzy front end stage p.101 • Stage 1: Discover • Stage 2: Definition • Stage 3: Design p. 102 • Stage 4: Development • Stage 5: Delivery • Example: p.103 Now let’s look at each of these. 18
  • 19.
    Stage 1: Discover Developa program plan: 1. Identify stakeholders’ needs, expectations 2. Define design alternatives that fit the above constraints 3. Allocate project budget 4. Define time-to-market 19
  • 20.
    Stage 2: Definition Selectthe design based on “life-cycle cost/benefit and risk analysis” i.e. likely to be most profitable vs. estimated risk. •The rest are “no go.” •Assign core team to lead implementation of the chosen project. 20
  • 21.
    Stage 3: Designp.102 • Analyze technological and operational modes (options) that best meet project constraints. • Core team prepares the project basic data set. Comprised of… • This design stage yields a more detailed project data set. still very incomplete, enough details to: • Evaluate its estimated costs, benefits and risks • Make an informed Go/No go decision 21
  • 22.
    Stage 4: Development:Use project data set from Design Stage to: p.102 • Build alternative project plans that fit project constraints of the data set. • Select the “best” one. Define “best.” • This decision process often involves getting the core team and key stakeholders together to agree on details (such as…?) 22
  • 23.
    Stage 5: Deliveryp.102 Project launch • This structured approach minimizes, but does not eliminate, the complexity, uncertainties, and risk of the NPD selection process. • Maximizes odds of success – of choosing the highest potential ROI relative to risk. 23
  • 24.
    Illustration: Defense sectorexample of parameters considered in front-end project management p.103 5 projects considered, each evaluated in terms of following parameters (at top of each column in the following table): • Cost • Scope • Complexity • Product type • Number of disciplines needed • Duration of project • Risk or Total Risk Level (TRL) 24
  • 25.
    Sample table ofprojects evaluated in fuzzy front end process 25
  • 26.
    Sample table ofprojects evaluated in fuzzy front end process (cont’d 1) 26
  • 27.
    Sample table ofprojects evaluated in fuzzy front end process (cont’d) 27
  • 28.
    SUMMARY PART 1:INITIATING NEW-STREAM INNOVATION PROJECTS New Product Development (NPD) – The Fuzzy Front End p98 1. Do the right project: The funneling process p. 99 2. Do the project right: Methodology flowchart p.100 3. Detailed description of the methodology for simulation of the fuzzy front end stage p.101 28
  • 29.
    PART 2: MANAGINGAND EVALUATING INDIVIDUAL INNOVATION IDEAS THROUGH THE PIPELINE p.107 29
  • 30.
    PART 2: MANAGINGAND EVALUATING INDIVIDUAL INNOVATION IDEAS THROUGH THE PIPELINE p.107 •Introduction p.p. 107 •2A: Use Project Management Philosophy, Tools, And Techniques p.108 •2B: 8 Tests To Identify “High Potential” Ideas For Innovation Investment p.109 30
  • 31.
    Part 2. Introductionp.p.107-8 Best practices for taking innovation initiatives from ideation to commercialization. •2A: Use Project Management Approach p.108 •2B: 8 Tests To Identify “High Potential” Ideas p.109 31
  • 32.
    Part 2A. UseProject Management (PM) Approach: Philosophy, Tools, & Techniques p.p. 108-9 4 key steps to applying PM to innovation: 1. Definition: Define the project 2. Division: Divide project into tasks 3. Sequencing: Plan task sequence 4. Budgeting: Create budget and resource plan 32
  • 33.
    Step 1: Definingthe project p. 108 •Define scope and objectives. •Identify the consumer and other relevant stakeholders. •Clarify resources needed. 33
  • 34.
    Step 2: Divideor break down project into tasks p. 108 •Each a manageable task or work package via formal “work breakdown structure.” •Each task small enough to handle for those assigned to it •Size of parties responsible for task vary with size of task, project, and organization. 34
  • 35.
    Step 3: Sequencing- plan task sequence p.p. 108 -9 • Some can be done in parallel others need to be in sequence. • Choose sequence that best meets time, cost, and quality constraints. Usually tradeoffs between speed, cost, and quality or performance. • Need to find tradeoff that best fits firm’s needs and priorities, as defined in step 1. 35
  • 36.
    Step 4 Budgeting:Create budget and resource plan • Once tasks defined & scheduled, estimate resources needed & include them in project budget. • If purchases from vendors, it’s a straight (price per unit or hours) x (units or hours needed) calculation. • If use internal resources like staff or machine time, calculate cost based on time and internal cost per hour estimates. 36
  • 37.
    Remember: Innovation requirescreativity and…. DISCIPLINE 37
  • 38.
    Part 2B: Identifying“High Potential” ideas for innovation investment – innovate or die p. 109 • Innovators: For example can innovate via: • New products, new markets (Apple) • New work processes s (Dell, Walmart, Amazon,) • New insights into demand (Formula 1 for budget hotels in Europe) • “Stagnators” • Eastman Kodak (photography) • Sylvania (light bulbs) • Xerox (copiers and….what else?) 38
  • 39.
    Can we distinguishwinners from losers early on? 39
  • 40.
    Part 2B: 8Tests To Identify “High Potential” Ideas p109 Test 1: Valuable benefits?: Why buy it? p.110 Test 2: Marketing?: Got channel & demand? Test 3: Scalability?: Mass produce efficiently? Quality? 112 Test 4: Leadership team: Qualified? p. 113 Test 5: Intellectual property control? Rights? p.114 Test 6: Financial return on investment: Good ROI? Test 7: Corporate social responsibility? Test 8: Fit with organizational strategy? p. 115 40
  • 41.
    Test 1: Valuablebenefits test: why buy THIS? THE main test of commercial viability. How is it superior to competing or substitute solutions? What is added value vs. the competition? Value proposition compelling & clear enough to be profitable? What problem solved, or delight provided, better, cheaper, or more conveniently, than the competition? Test: can you articulate the value proposition clearly and succinctly? 41
  • 42.
    Example 1: Clear,short value proposition template For the target customer Who specific needs, requirements, demands, buying criteria We provide solution name/description That gives specific business benefits/value to clients Unlike the competition Who provide solution, features, functions, benefits Our company more/better approach, solution, functions, benefits That offers a better customer experience 42
  • 43.
    Exercise: Write aclear, short value proposition using this template Can you fit your value proposition into this template? “For ______________ who _______________, we provide ________________________________ that ________________________________. Unlike other [your industry, for example, IT services] firms, who ________________________, our company ______________________________ that _______________________________.” 43
  • 44.
    Test 2: Marketing:channel & demand? p. 111 1. Channels: Can we establish effective supply chain & distribution channels? 2. Enough demand at profitable price point? 44
  • 45.
    Test 3: Scalability?Mass produce efficiently? Quality? p.112 Once we move to mass production and distribution: •Unit costs stay within budget? •Maintain quality, reliability, customer support? •Will it function ‘in the field’ under all anticipated conditions? 45
  • 46.
    Test 4: Leadershipteam: qualified? p. 113 1. Individual members have the skills, personality traits, experience to do their jobs? 2. Does the team as a whole: a) Have the full set of complementary skills & experience to lead whole project? b) Function together as cohesive unit under stress typical to new product development & launch? 46
  • 47.
    Got the rightteam to succeed? 47
  • 48.
    Test 5: Intellectualproperty (IP): Control? Rights? p.114 Have control or rights to all relevant IP via one or more of the following: 1. For IP we created: protect & control rights + access via : a) Blocking strategies to prevent others from legally. b) “Run fast”: simply plan on innovating faster and staying ahead of competition. (cont’d next slide) 48
  • 49.
    Test 5: Intellectualproperty (IP) p.114 (cont’d) 1. For IP we created: protect & control rights + access via (cont’d): c) Clear, documented efforts to hide the IP as a “trade secret.” d) Form joint ventures (JVs) with other entities to share IP. 2. For IP we don’t control, license or purchase relevant IP rights for relevant jurisdictions (where will sell it) 49
  • 50.
    Test 5: IP(cont’d)– consequences of failure can be DIRE! Long, expensive legal battles, like Apple vs Samsung. Each has billion dollar annual IP budget. An IP dispute can kill a small company by draining needed resources (time, money) or scaring off potential investors. 50
  • 51.
    No regrets! –secure your IP 51
  • 52.
    Test 6: Financialreturn on investment 52
  • 53.
    Test 6: GoodROI? Minimum ROI required?: For-profit enterprises usually require a minimum return on investment (ROI) for a given level of risk. Consider Risk Premium: The higher the risk, the higher the expected ROI to justify the investment. 53
  • 54.
    Beware of excessivefocus on high rates of return 54
  • 55.
    Test 7: Socialresponsibility: environmental, social & community outcomes OK? p. 115 1. Environmental: impact is neutral or positive. 2. Social & community: If material threat of vocal resistance from groups hurt by the project, consider steps to minimize/eliminate threat. 3. Related issues: legal compliance, reputation, “5 P’s” people planet, public probity, and profit outcomes. 55
  • 56.
    Test 8: Fitwith organizational strategy – Introduction p. 115 “In-house” commercialization of valuable IP isn’t always the best option. Reasons to sell, license, or share technology (via JV) include: 1. Lack internal resources/capabilities: Lack funds, channels, expertise. 2. Lack strategic fit: if invention is unrelated to the core business, in-house commercialization risks diluting or losing focus on existing mainstream business lines. 56
  • 57.
    Test 8: Fitwith organizational strategy - Bank Example (1) p. 115 A large bank produced a certain software innovation that service and had potential well beyond that bank’s applications and industry. Two basic options: 1. retain the IP and: a.Keep exclusive use as a trade secret, to create a competitive advantage b.commercialize it internally, sell as a product/service, as a separate profit center 2. Sell or license it to a third party for development and distribution 57
  • 58.
    Test 8: Fitwith organizational strategy - Bank Example (2): Cost/benefit vs. strategic considerations p. 115 Cost/benefit per 8 tests: A first consideration - how can we best create revenue and profit from it? How ensure it passes these 8 tests? Overall business strategy concerns: However, there are multiple strategic issues that are likely to be at least as important. Strategic questions include…. 58
  • 59.
    Test 8: Fitwith organizational strategy – Bank Example (3) List of strategic considerations (p. 116) 1. Impact on long-term competitive advantage in existing banking markets? 2. Dilution risk & how manage it? Commercialize in house vs. sell/lease/JV? 3. How will existing customers react to our decision? 4. How will it impact our reputation? 5. What are the strategic risks and returns? 6. If 3rd party commercializes it, can we control distribution to deny access to our direct competitors? 59
  • 60.
    Test 8: Fitwith organizational strategy - Bank Example (4) Their decision (p. 117) Avoided dilution risk: spun off the software to a 3rd party IT business capable of marketing it, under its own brand and license. Accepted risk of losing potential long term new revenue stream and competitive advantage. Denying access to competitors impossible. The bank negotiated a three-year lead time before buyer could sell the software to competitors. 60
  • 61.
    Test 8: Fitwith organizational strategy - Nokia case (p. 117) Strategic principles, such as retaining focus, don’t always apply. Nokia developed new mobile phone technology while main business was timber / forestry. Mobile phones & timber not good strategic fit. But Nokia’s shareholders gained a decade of great wealth creation. Only in retrospect is it clear Nokia decided correctly. Mobile phone opportunity was vast, & Nokia’s internal capabilities proved capable. Thus the opportunity justified the dilution risk. 61
  • 62.
    Using these 8tests p. 117 These 8 tests are filters for selecting projects with best cost/benefit relative to risk of underperformance or failure. Apply them throughout the NPD process, not just at the earlier stages of the fuzzy front end. Indeed, as project advances, have more information and evidence, so can apply the tests more accurately. They apply to organizations of all sizes: albeit in different ways. For example, test complexity typically grows with size of the company. 62
  • 63.
    PART 3: THEPORTFOLIO OF INNOVATION STRATEGIES 63
  • 64.
    PART 3: THEPORTFOLIO OF INNOVATION STRATEGIES Introduction - 1 p.p. 119-20 Evaluate projects not only by their individual merits per the 8 tests, but also by how well they fit with the firm’s portfolio of ongoing innovation projects. If the IP portfolio is weak in filling certain company needs, then projects that DO meet those needs become more desirable, and might be chosen over others with higher overall scores in the “8 tests.” 64
  • 65.
    PART 3: THEPORTFOLIO OF INNOVATION STRATEGIES Introduction - 2 p. 120 Just like a football team needs 11 players with different skills at different positions, so too the IP portfolio needs projects that fill different company needs. Thus at times, a team might choose a lesser player over a better one, if that player best fills a certain skill gap on the field. Similarly, an organization’s “Go/No go” decision might depend more on what gaps it needs to fill than on which project ranks highest in overall individual merit per the “8 tests.” 65
  • 66.
    Example: The needfor steady earnings Organizations have many goals, like long-term survival & competitiveness, and meeting various compliance and performance measures. For example, companies prefer steady earnings, ideally steadily rising earnings. Why? Investors hate risk. They interpret steady performance to imply lower risk. They’ll pay more for shares in these lower risk businesses, and pay their managers better. Thus (all else being equal) firms prefer steady over volatile earnings and other measures of financial performance. 66
  • 67.
    Example (cont’d): Howthe need for steady earnings influences “Go/No Go” decisions One way firms try to keep earnings steady is by timing new products and services launches, and their implied earnings streams. Thus a lower ROI project might be approved over higher yielders if it is the one most likely to produce a given earnings stream when needed. 67
  • 68.
    Example 1: Atypical new product NPV probability distribution 68
  • 69.
    Example 1: Re-evaluatinga project’s estimated NPV throughout the NPD process Throughout the NPD process, we repeatedly apply the 8 tests to re-evaluate project viability and its probable net present value (NPV). During the development phase of each project, its NPV probability distribution would shift based on new information. For example: • solving a technical problem might increase estimated NPV, thus shifting the NPV probability distribution to the right • doing some market research would likely move the distribution to the left or right, depending on whether the research indicated a higher or lower chance of success 69
  • 70.
    Example 1: Re-evaluatinga project’s estimated NPV throughout the NPD process (cont’d) So for each new innovation initiative we can formulate a dynamic approach to probabilistic value creation on a project-by-project basis. The next illustration adds timing estimates of that revenue stream, and for an entire portfolio of innovations. Thus it illustrates how firms would be identify projects most likely to produce a given earnings stream when needed to keep revenues steady, and ideally, steadily rising. 70
  • 71.
    Example 2: NPVprobability and timing estimates for each project in an entire innovation portfolio 71
  • 72.
    Example 2: Estimatingprobable value AND its timing for each project in an innovation portfolio Here’s another approach to measuring and managing the portfolio of innovations: showing both estimated project value AND its timing. Expected value of success = (a single probability of success estimate) x (estimated value created upon success) Value = revenue, or profit estimates (or both). This approach allows firms to identify and select projects that will contribute value when needed to keep earnings steady and/or rising. 72
  • 73.
    Example 2: Explanation& comments Outer circle size shows project profitability, the inner circle showing probability weighted against expected profit Horizontal axis shows timing of first revenue expectation (launch date). Vertical axis shows the divisional split of these products or another categorization. Illustration 2 communicates a picture of both: • Potential and likely value of each project • timing of that value – allowing selection based on value timing needs 73
  • 74.
    Summary Part 3:Portfolio of Innovation Strategies Evaluate projects not just on their individual merits, but also on how well they fit with the firm’s overall goals. For example, a firm might select a project ahead of others that score higher on the 8 tests because it: • Delivers a given value stream when needed to keep certain financial metrics steady or steadily rising • Provides diversification into a certain product category or emerging technology in which the firm wants a presence 74
  • 75.
    LECTURE SUMMARY MANAGING THEINNOVATION PORTFOLIO AND PROJECTS 75
  • 76.
    PART 1: INITIATINGNEW-STREAM INNOVATION PROJECTS p.98 New Product Development p.98 • Do the right project: The funneling process p. 99 • Do the project right: Methodology flowchart p.100 • Detailed description of the methodology for simulation of the fuzzy front end stage p.101 • Stage 1: Discover • Stage 2: Definition • Stage 3: Design p.102 • Stage 4: Development • Stage 5: Delivery 76
  • 77.
    PART 2: MANAGINGAND EVALUATING INDIVIDUAL INNOVATION IDEAS THROUGH THE PIPELINE p.107 2A: Use Project Management Philosophy, Tools, And Techniques p. 108 4 key steps to applying project management to innovation •Definition: Define the project •Division: Divide or break down project into steps •Sequencing: Plan sequence of tasks •Budgeting: Create budget and resource plan 77
  • 78.
    PART 2: MANAGINGAND EVALUATING INDIVIDUAL INNOVATION IDEAS THROUGH THE PIPELINE p.107 (cont’d) 2B: 8 Tests To Identify “High Potential” Ideas For Innovation Investment p109 • Test 1: Valuable benefits test / valuable benefits? p. 110 • Test 2: Marketing test: Got channel and demand? p. 111 • Test 3: Scale up/ Scalable? p. 112 • Test 4: Leadership team p. 113 • Test 5: Intellectual property p. 114 • Test 6: Financial return on investment / ROI • Test 7: Corporate social responsibility • Test 8: Fit with organizational strategy p. 115 78
  • 79.
    PART 3: THEPORTFOLIO OF INNOVATION STRATEGIES Evaluate projects not just on their individual merits, but also on how well they fit with the firm’s overall goals. Projects that might have lower overall scores on the 8 tests in Part 2 might still merit selection if they fill a gap or weakness in the innovation portfolio’s ability to meet those goals. 79
  • 80.
  • 81.
    SPECIAL SUPPLEMENTARY TOPICS --INNOVATIONAND ENTEREPRENEURSHIP THOUGHT LEADERSHIP --CASE STUDIES 81
  • 82.
    Case Study: Innovationthe Lego way p. 105 Lego goes from near bankruptcy to financial health, robust growth. How? By building capability for systematic innovation that produces wide range of successful new products &product lines. “Executive Governance Group” means innovation culture from the top down, lead by senior management Lego divided operations into 8 areas, seeks to drive innovation in all, thus fuel continued growth. 82
  • 83.
    TOTAL INNOVATION p.106 (Nagil & Tuff, 2012) For every project portfolio, allocate a certain proportion of projects & resources to these types of products and innovation levels: • Core: incremental changes to existing offerings (Mercedes Benz “AMG” or VW “GTI,” sportier versions of existing models) • Adjacent: expanding into related products, such as moving along the value chain (e.g. from Apple products to Apple stores). • Transformational: innovating to create new products for new markets (Sony Walkman, or Tesla’s high-performance pure electric vehicle) 83
  • 84.
    POSITIONS IN MARKETSAND PORTFOLIOS: TACTICS TO POSITION INNOVATIONS p. 107 Schmidt and Rhee (2014) • A low-end approach: if performance is weak, lower price point to draw price- conscious consumer (Formula 1 hotels, Air Asia). • A high-end approach: if proven high performance, high price (Porsche Cayenne) • A niche-features approach: if has specialized benefits highly valued by small market segment, high price if they’re affluent (memorabilia) • Other examples: new-attributes high-end, radical innovation, etc. • Choose one, or a portfolio of approaches that mixes positioning and price points. 84
  • 85.
    VALUE CREATION THROUGHINNOVATION p. 110 Kim & Mauborgne, 2004 For some firms, their innovations themselves are their unique value added that differentiates them from competitors. For example: • Formula 1 hotels’ innovation: Eliminate or minimize what customers don’t value, excel in the real value drivers (bed quality, room quietness, hygiene), cut cost significantly. • Other examples: Ikea (beautiful cheap furniture, good service & cheap delivery), Air Asia, etc. 85
  • 86.
    CASE STUDY: NEWZEALAND NATURAL: MARKET-DRIVEN ICE-CREAM INNOVATION p. 111 Struggling ice cream chain becomes successful via innovation. Key insight & innovation: taste preferences vary across regions , depending on culture, diet, so match flavors to local tastes. • Chinese eat few dairy products, so they prefer less sweet flavors, like green tea flavor, which masks a strong dairy presence • In contrast, US consumers eat more dairy products and sweets, like ‘cookies and cream’ flavor. 86
  • 87.
    WORLD’S BEST INNOVATIONPRACTICES? P&G – “AGILE GIANT” p. 113 Brown & Anthony, 2011 • Focus on what consumers want: make it simpler, more convenient, cheaper. • Strategic portfolio mindset: disciplined active measuring & managing projects, ‘by the numbers’ & strategically (contribution to overall P&G needs/priorities). • Trial & error • Big bets based only after successful small bets provide validation • Invests in resources needed to succeed + education, interdisciplinary idea exchange 87
  • 88.
    RADICAL AND INCREMENTALINNOVATION p. 117 Treacy, 2004 Innovation portfolios need to strike a balance between the proportion of radical and incremental innovations. Incremental innovations help maintain revenues, market share, and customer satisfaction while the next disruptive innovation remains under development. Failing to invest in higher risk radical innovations carries its own dangers: risk of missing the next technology that could threaten your core business, or of missing the next chance for outsized value creation and growth. 88
  • 89.
    MATCH THE APPROACHTO THE MARKET DEVELOPMENT p. 118 Moore, 2004 Overview: Moore categorizes innovations into 7 distinct types or stages He asserts that: Specific types of innovations tend to work best in at certain stages of a market’s development or maturity Therefore your innovation strategy should be to first understand what stage of development your market has reached, then focus resources on the kinds of innovation that best suit that kind of market. Now look at details:…. 89
  • 90.
    MATCH THE APPROACHTO THE MARKET DEVELOPMENT (cont’d 1): 7 Types Innovation p. 118 Moore, 2004 1. Disruptive: where new markets are created, can grow fast and furiously (social media & Facebook) 2. Application innovation: existing models or technology applied to new industries (sharing business models such as Uber& Airbnb use existing technology applied to taxi and lodgings) 3. Product innovation: incremental innovation to existing products (most Apple products) 4. Process innovation: innovations in supply chain, distribution channels (Dell, Walmart). 5. Incremental refinements to existing offerings: (software upgrades) 6. Marketing innovation: (Amazon customized emailing, EBay online auctions 7. Business model innovation: (Amazon’s shaping cloud computing or Apple’s shift into online music supply and retail bricks-and-mortar Apple stores. 90
  • 91.
    MATCH THE APPROACHTO THE MARKET DEVELOPMENT (cont’d 2): Market Maturity Stages p. 118 Moore, 2004 1. Early stage: new market, rapid growth as demand spreads to general population (the bottom and rapidly rising middle of the “S” curve 2. Middle Stage: achieve mainstream penetration, upper half of steep part of “S” curve. Demand growing but so is competition. 3. Mature stage: hitting upper, flattening part of “S” curve 91
  • 92.
    MATCH THE APPROACHTO THE MARKET DEVELOPMENT (cont’d 3): p. 118 Moore, 2004 • Innovation types 1-2 most effective in early stage markets • Types 3-4 best fit for middle stage markets • Types 5-7 for late stage 92

Editor's Notes

  • #8 ScreenHunter_04 May. 01 20.36.jpg
  • #26  ScreenHunter_04 Apr. 21 11.57.jpg CLIFF DESKTOP
  • #27 ScreenHunter_05 Apr. 21 11.58.jpg
  • #28 ScreenHunter_06 Apr. 21 11.59.jpg
  • #30 ScreenHunter_07 May. 02 23.43.jpg
  • #38 Image; ScreenHunter_08 May. 01 21.25.jpg
  • #40 Losers ----- JPEG File ----- [Filename] ScreenHunter_01 Apr. 22 11.58.jpg [Size] 38 KB Winner eg image ipad -- JPEG File ----- [Filename] ScreenHunter_02 Apr. 22 12.01.jpg [Size] 47 KB
  • #52 IMAGE: ScreenHunter_07 May. 01 21.21.jpg
  • #53 [Filename] ScreenHunter_01 Apr. 23 20.59.jpg
  • #69 ----- JPEG File ----- [Filename] ScreenHunter_01 Apr. 25 09.32.jpg [Size] 10 KB
  • #72 [Filename] ScreenHunter_02 Apr. 25 09.58.jpg
