Getting started
using Kanban

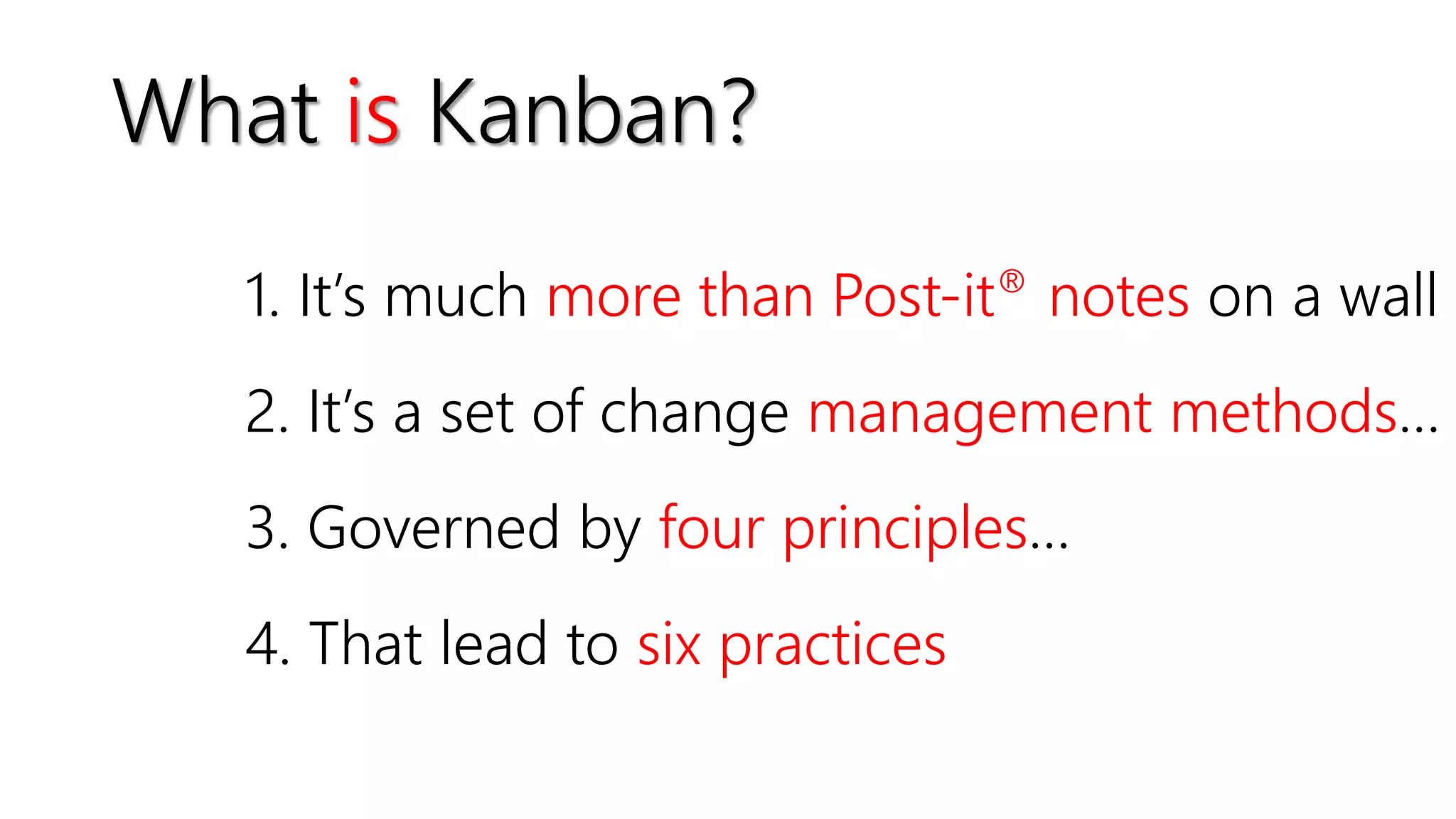

What is Kanban?
1. It’s much more than Post-it® notes on a wall
2. It’s a set of change management methods…
3. Governed by four principles…
4. That lead to six practices

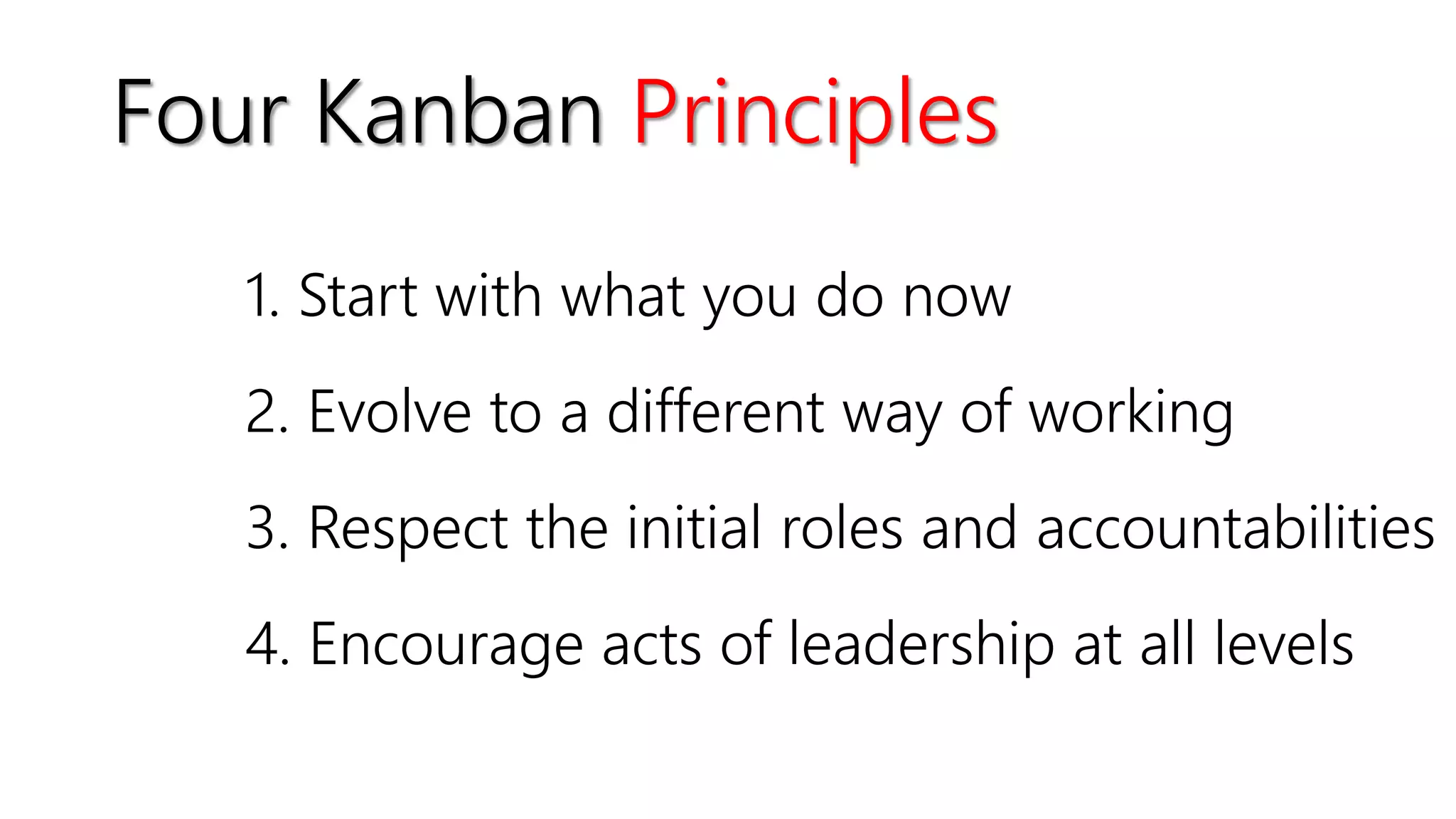

Four Kanban Principles
1. Start with what you do now
2. Evolve to a different way of working
3. Respect the initial roles and accountabilities
4. Encourage acts of leadership at all levels
1. Visualize the work
2. Limit WIP (Work in Process)
3. Measure & manage flow
4. Make system policies explicit
5. Create feedback loops
6. Collaborate & experiment to improve

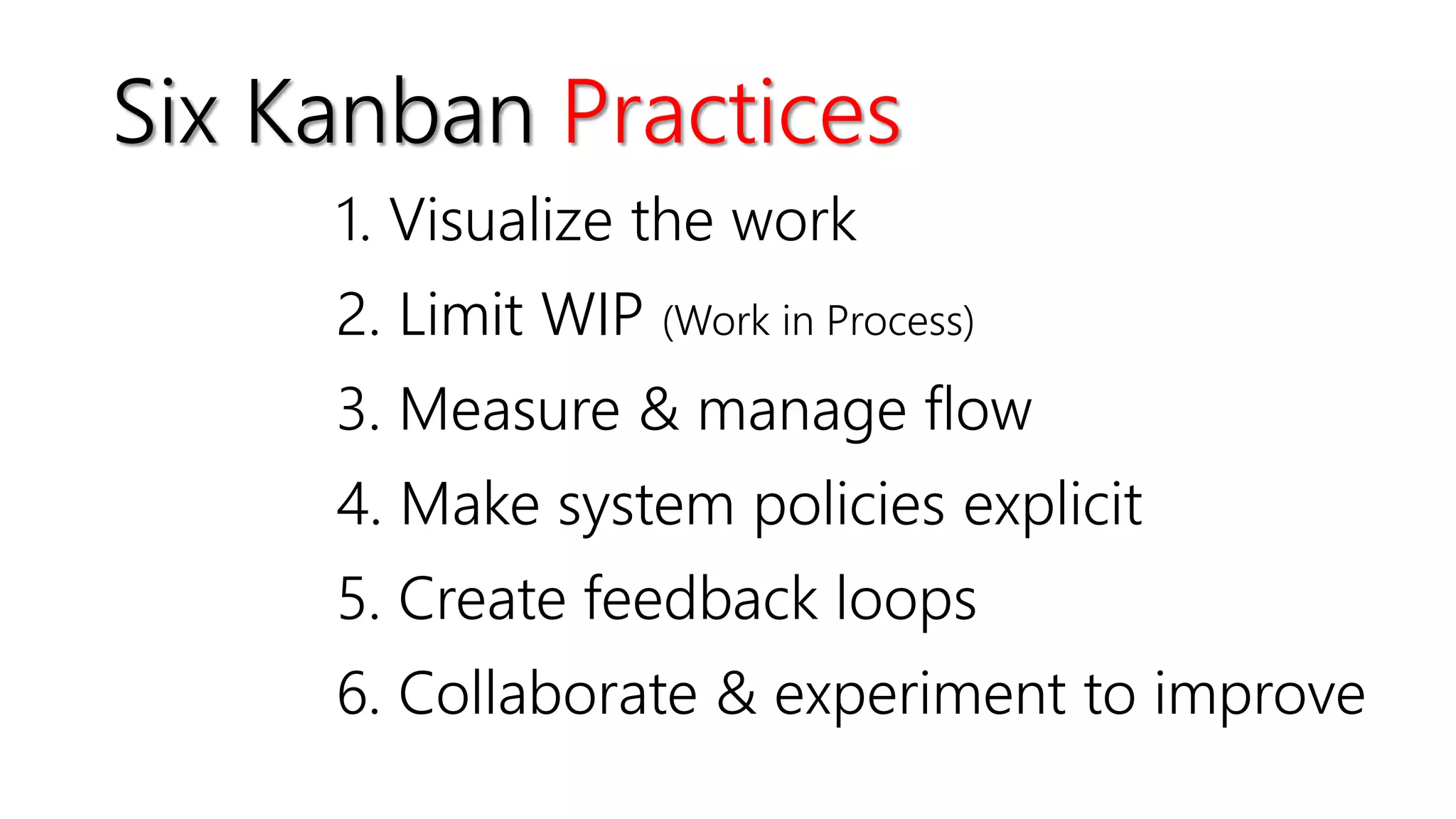

Six Kanban Practices

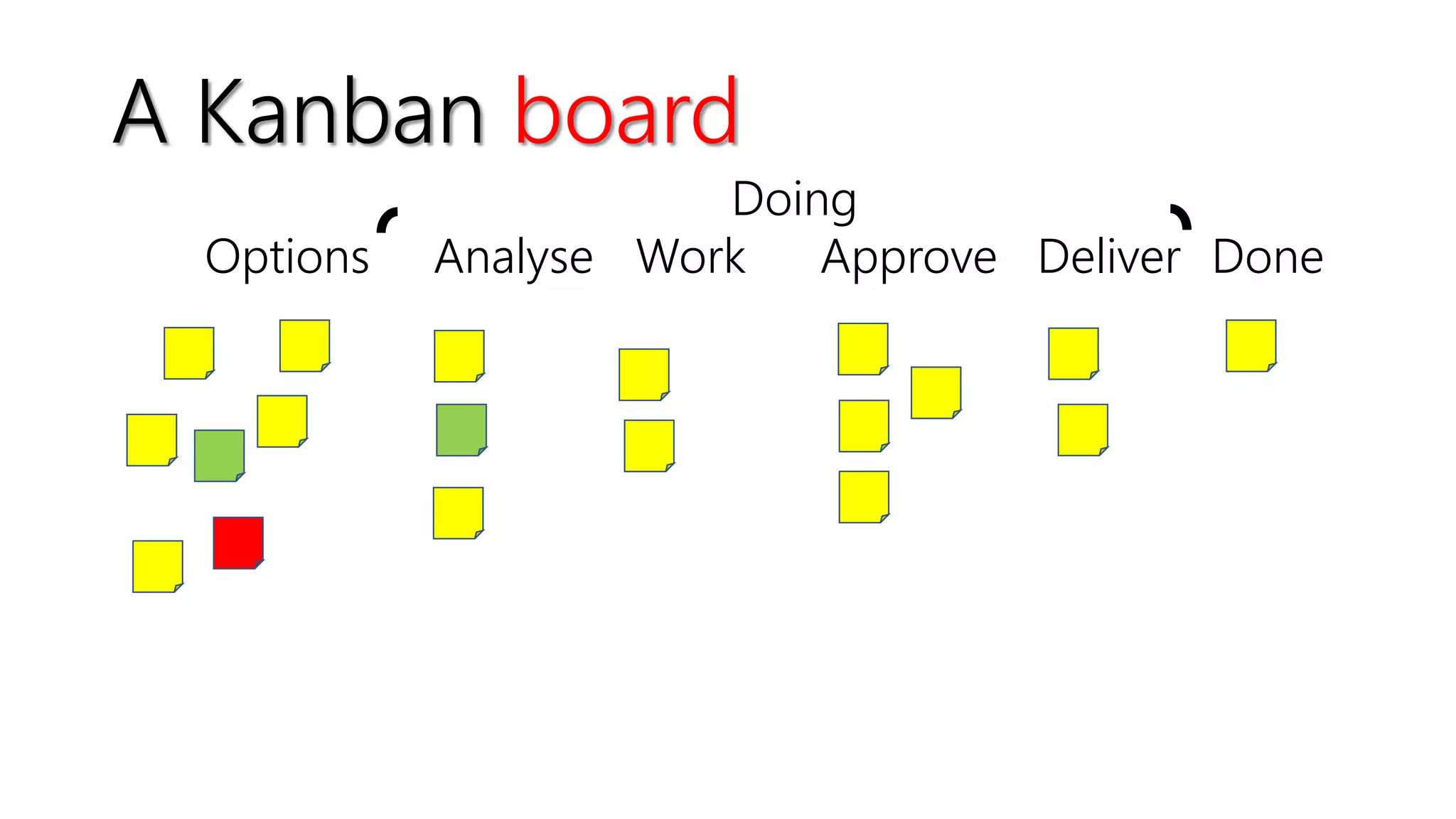

Doing
Options Analyse Work Approve Deliver Done

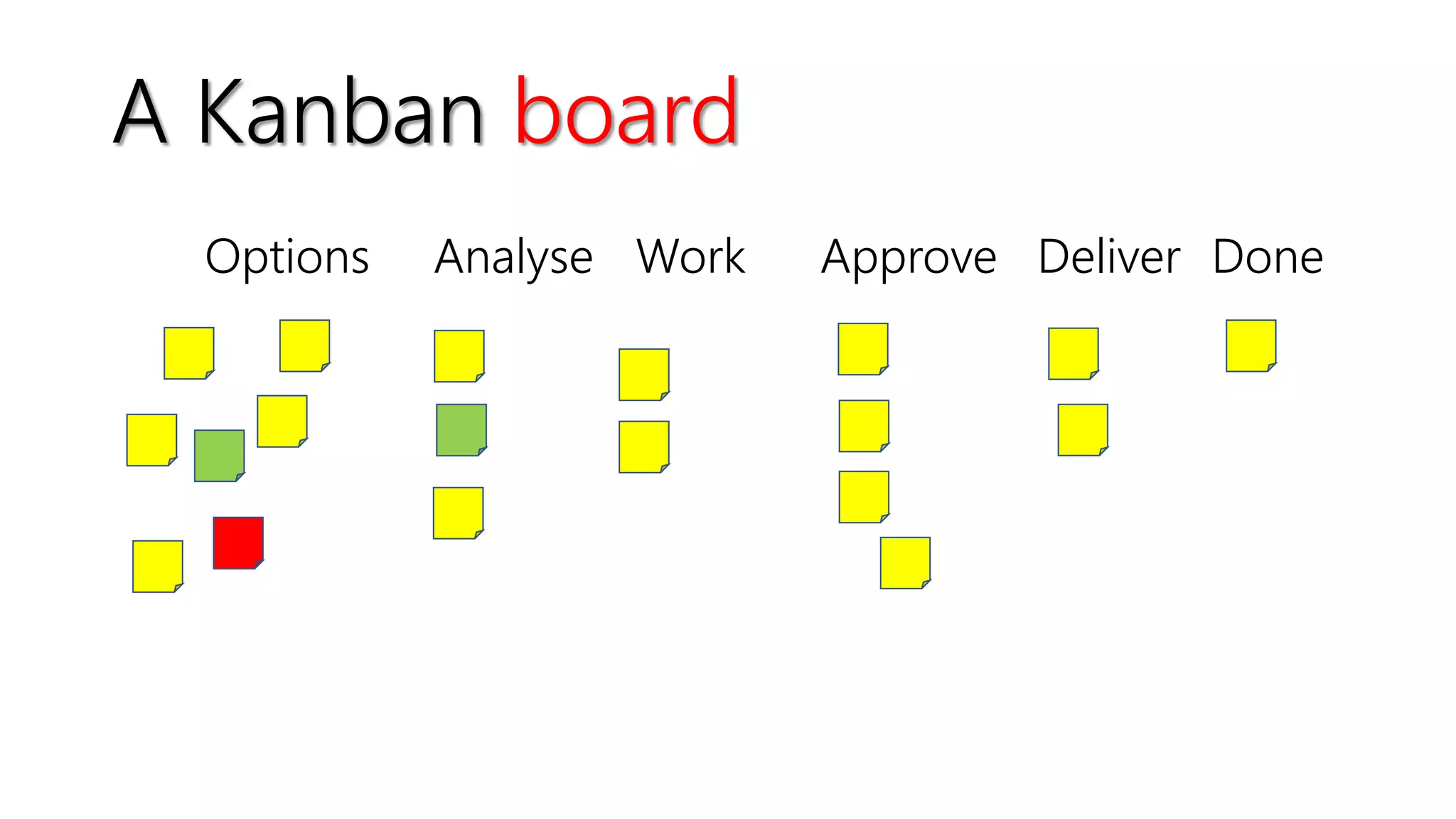

A Kanban board
Doing

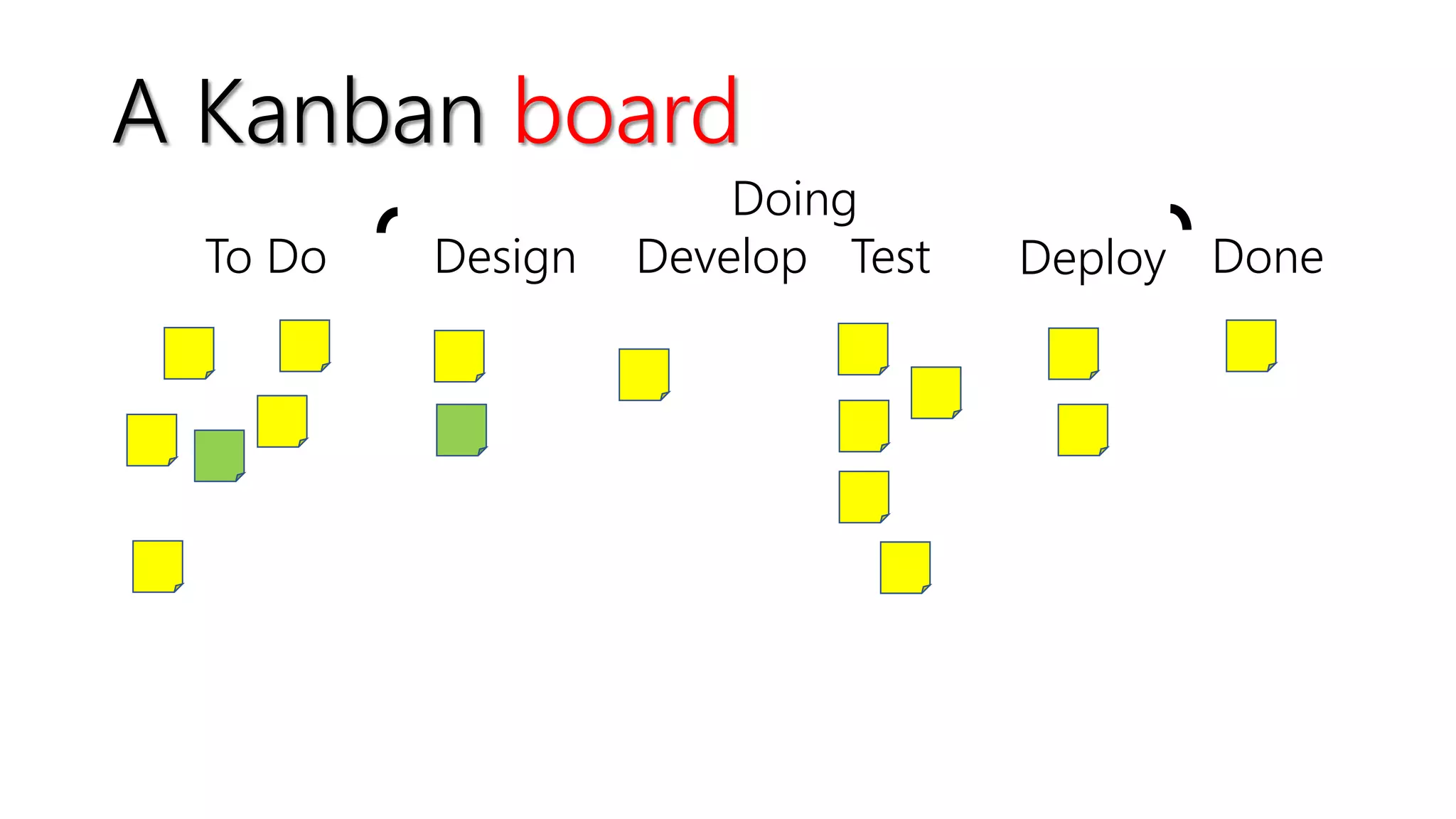

To Do Design Develop Test Deploy Done
A Kanban board
Options Analyse Work Approve Deliver Done
A Kanban board

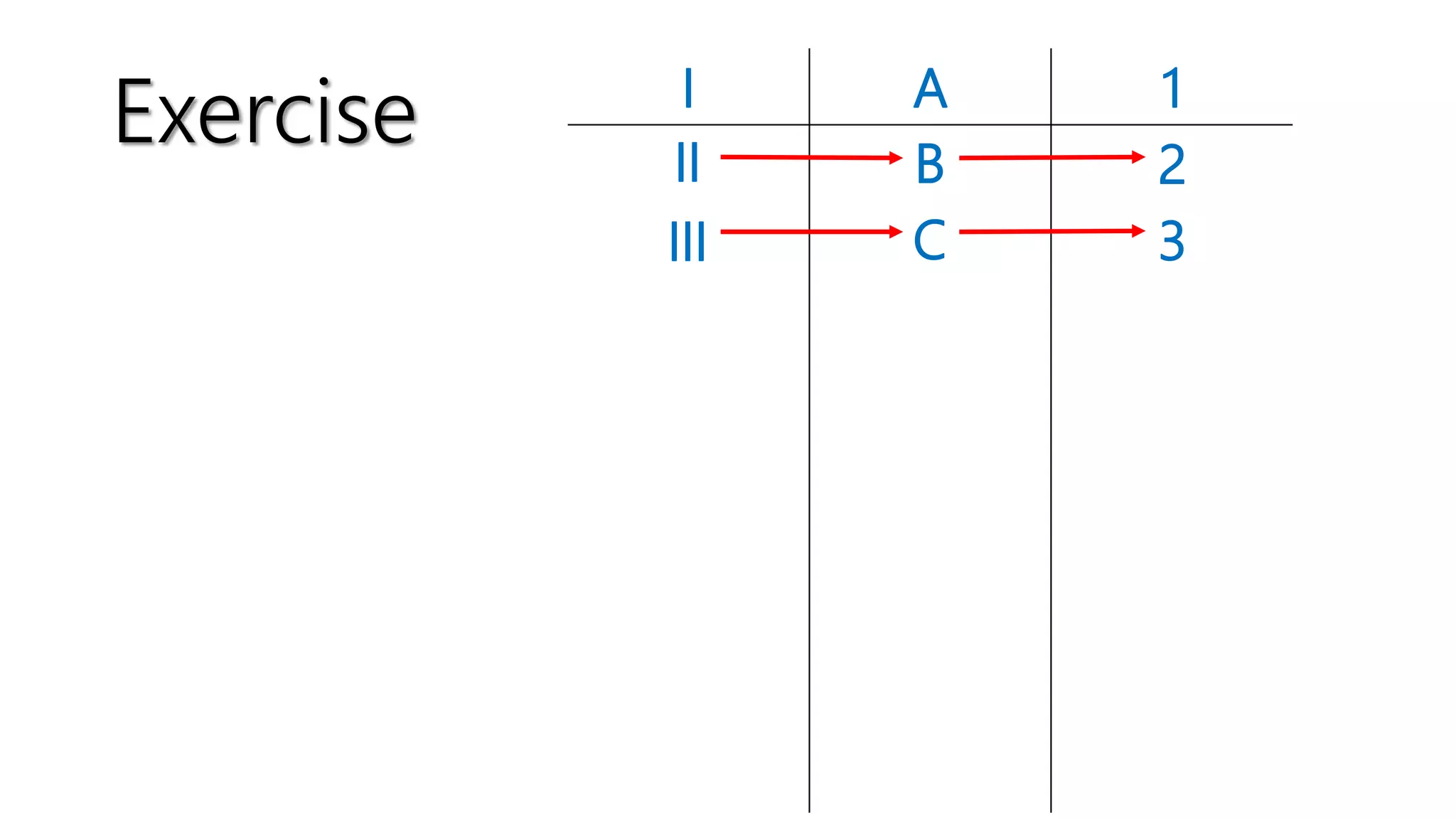

Exercise I A 1
II
III
B
C
2
3

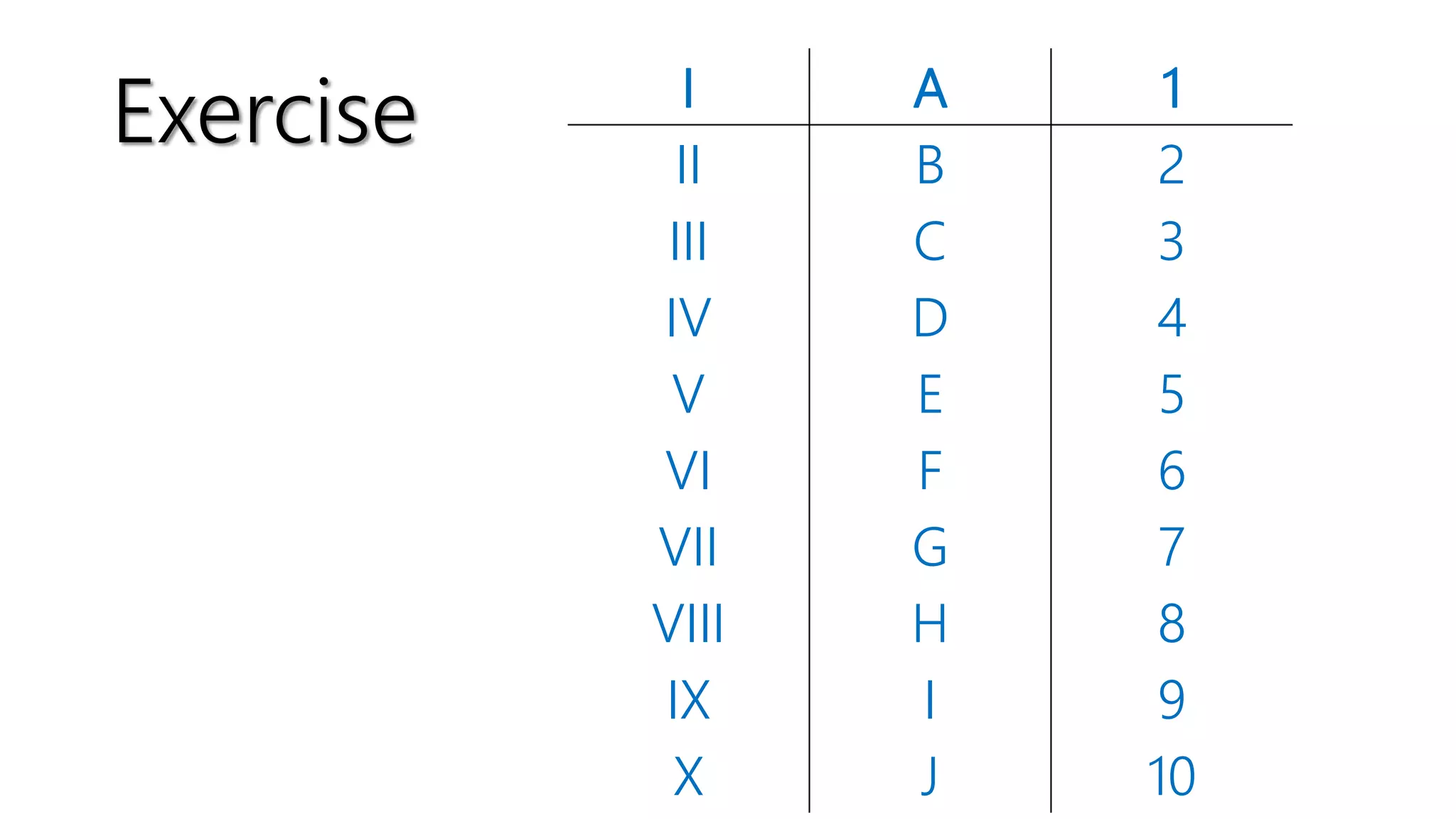

Exercise I A 1
II B 2
III C 3
IV D 4
V E 5
VI F 6
VII G 7
VIII H 8
IX I 9
X J 10

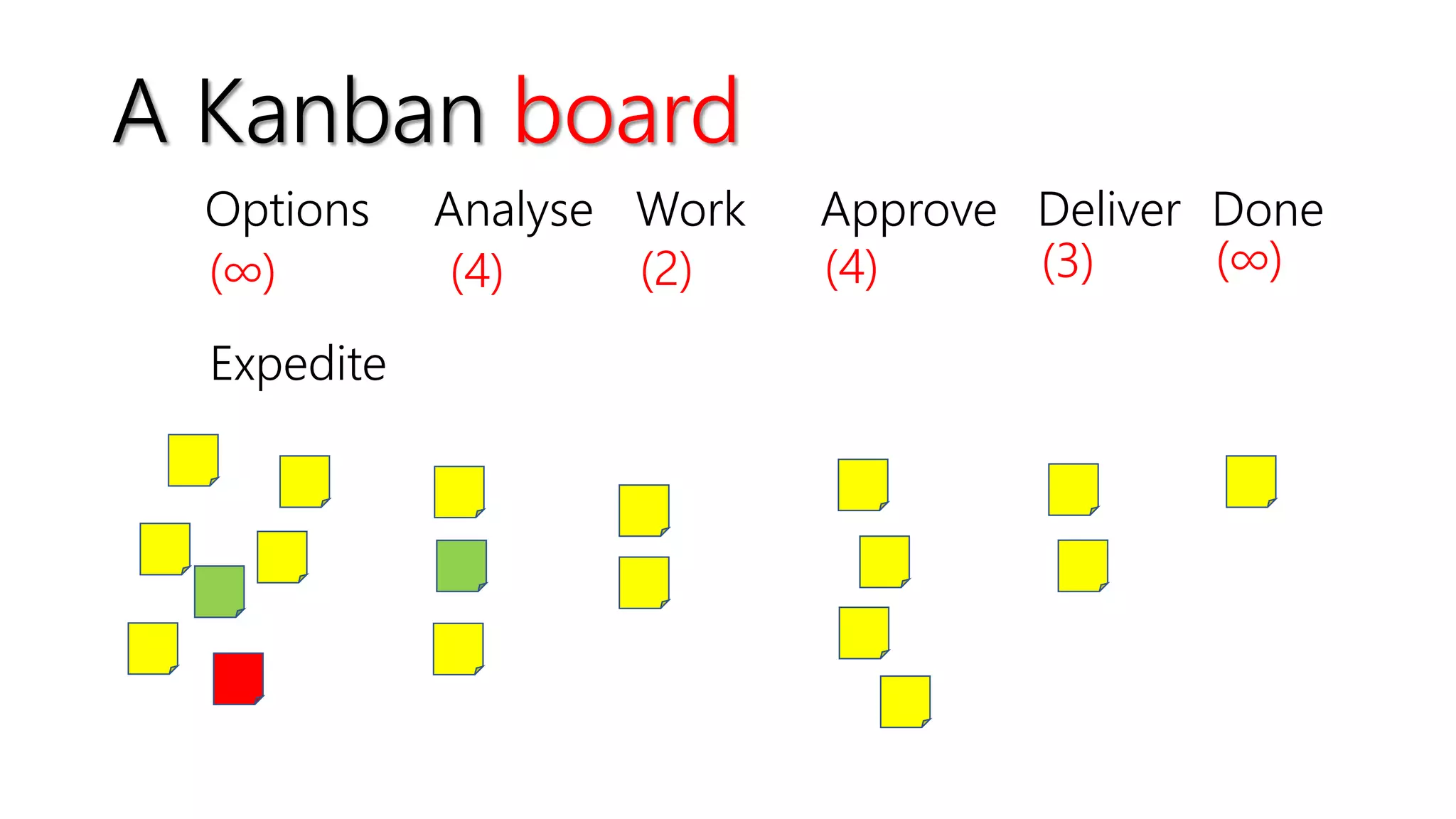

Options Analyse Work Approve Deliver Done

A Kanban board
A Kanban board

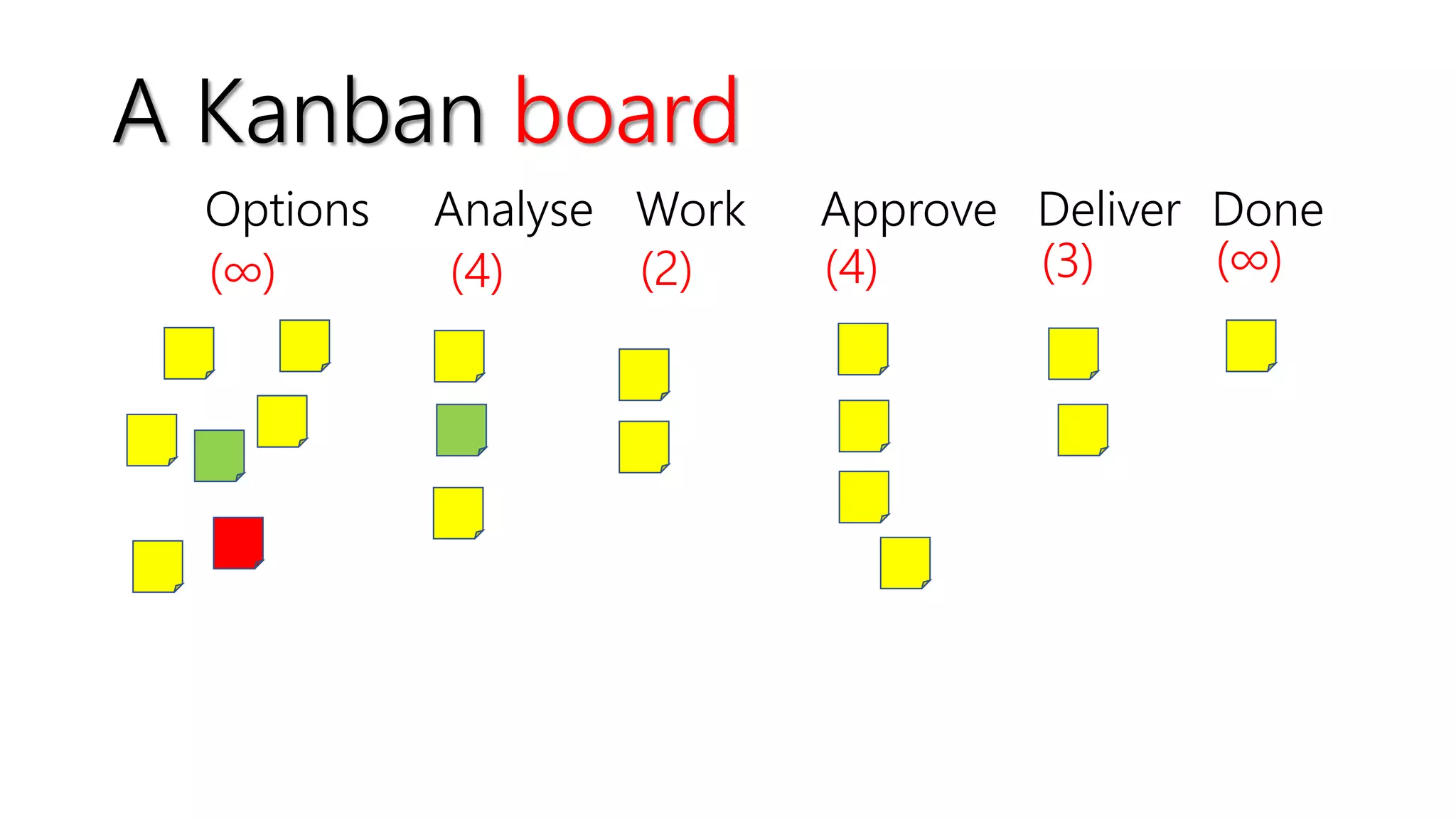

(∞) (4) (2) (4) (3) (∞)
Options Analyse Work Approve Deliver Done
A Kanban board
(∞) (4) (2) (4) (3) (∞)
Expedite
Options Analyse Work Approve Deliver Done

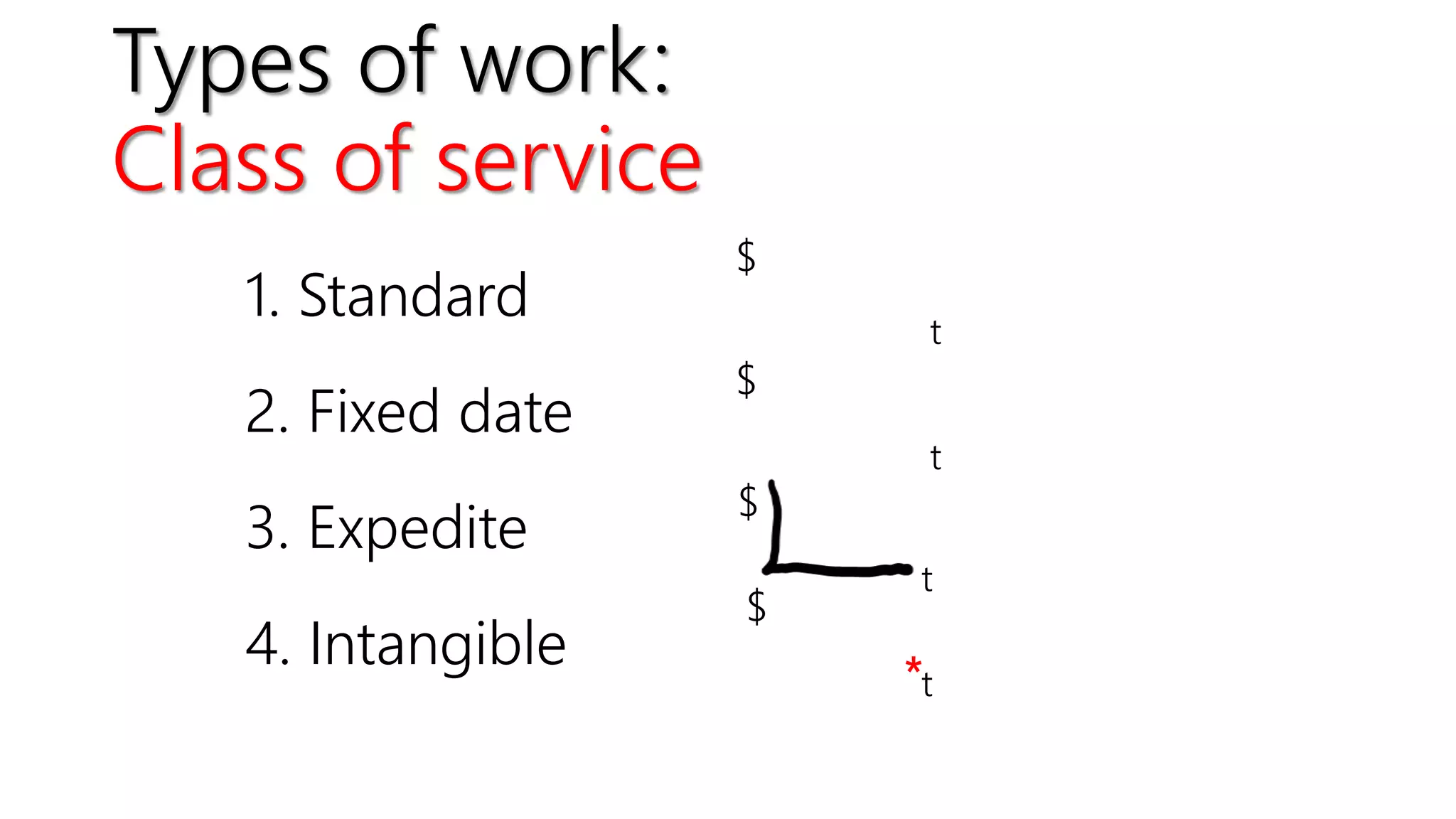

Types of work:
Class of service
1. Standard
$
t
3. Expedite
$
t
2. Fixed date
$
t
4. Intangible
$
t*

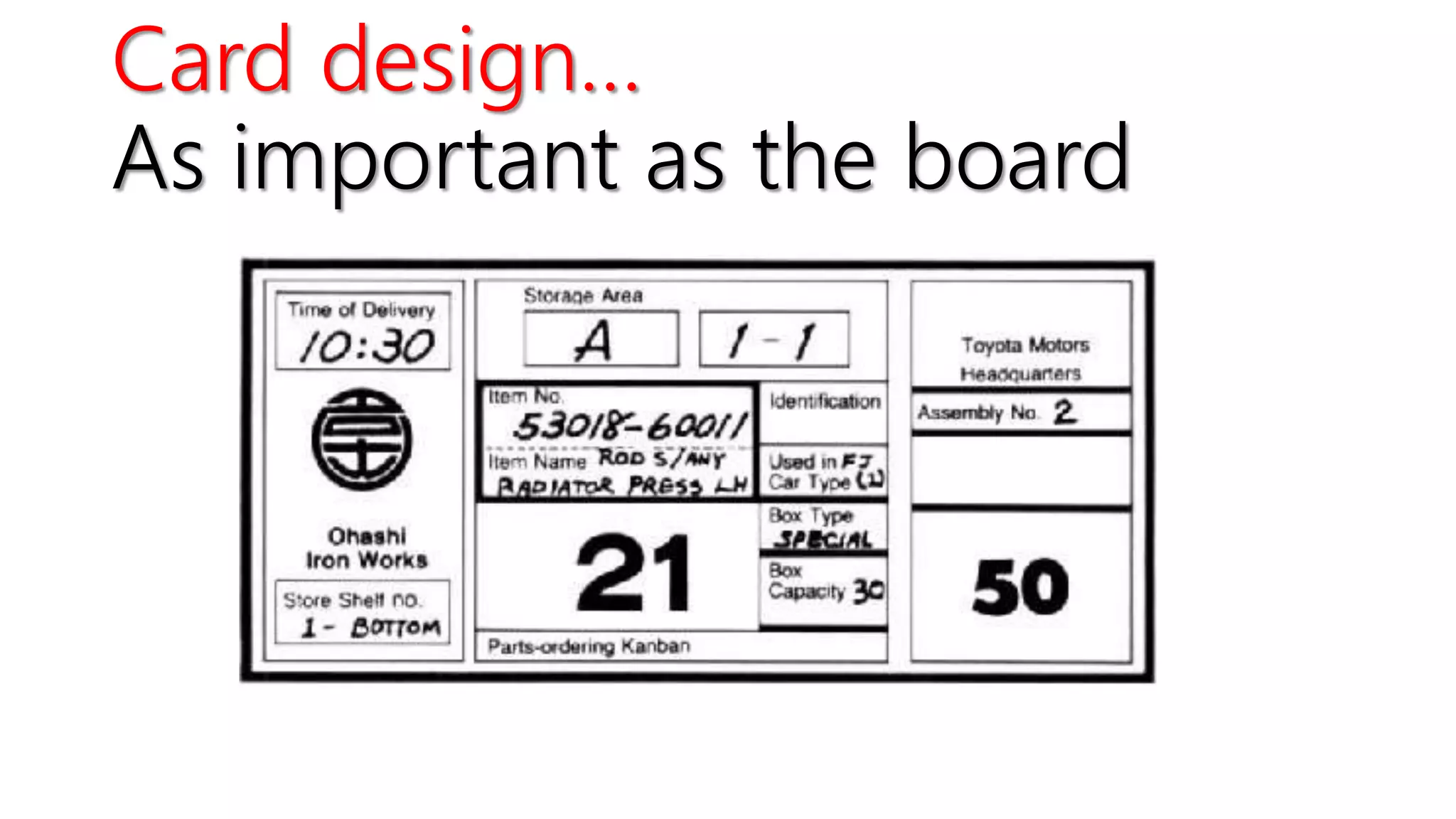

Card design…

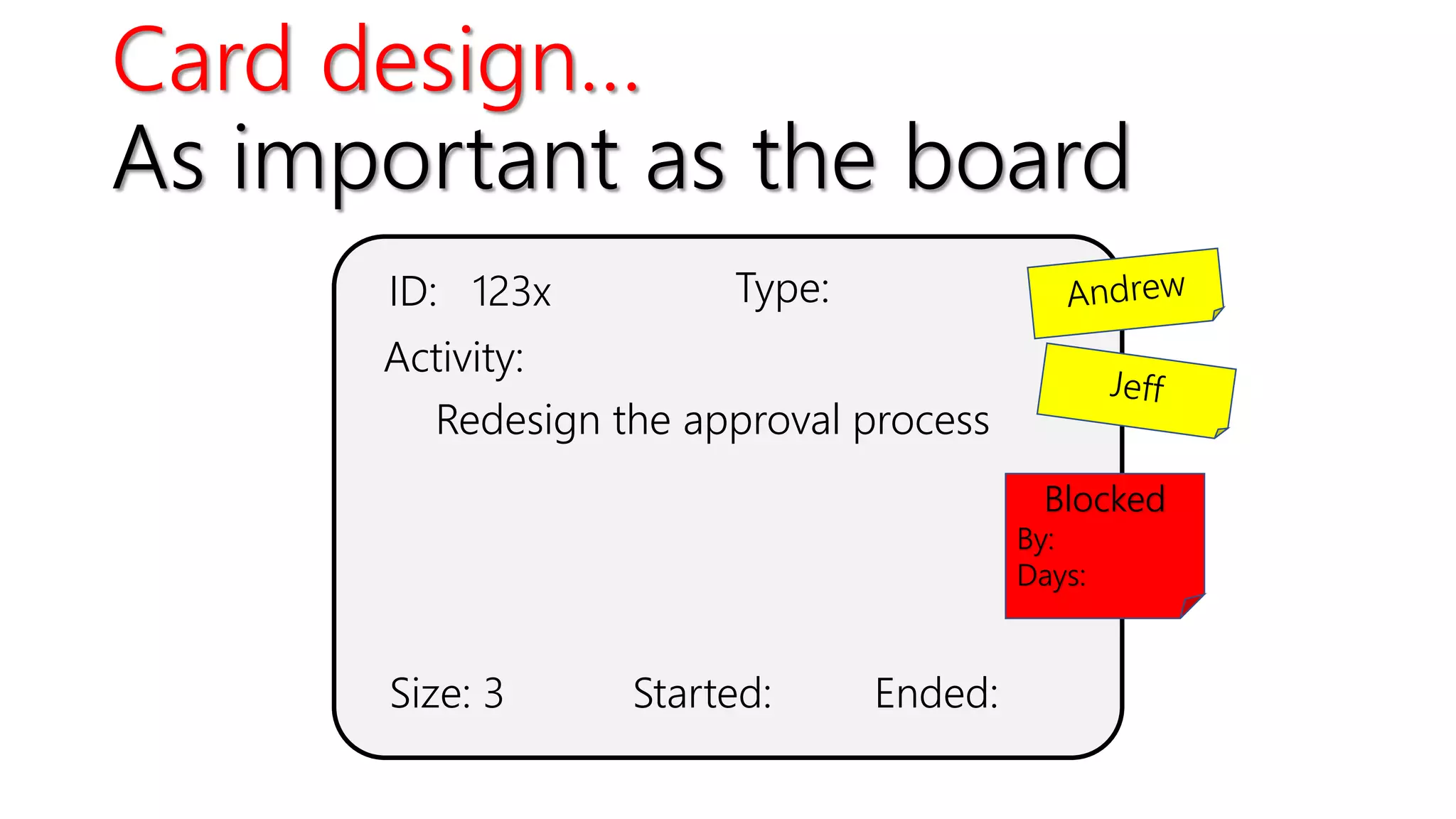

As important as the board
Size: 3 Ended:Started:
Activity:
Blocked
By:
Days:
ID: 123x
Redesign the approval process
Type:
Card design…
As important as the board

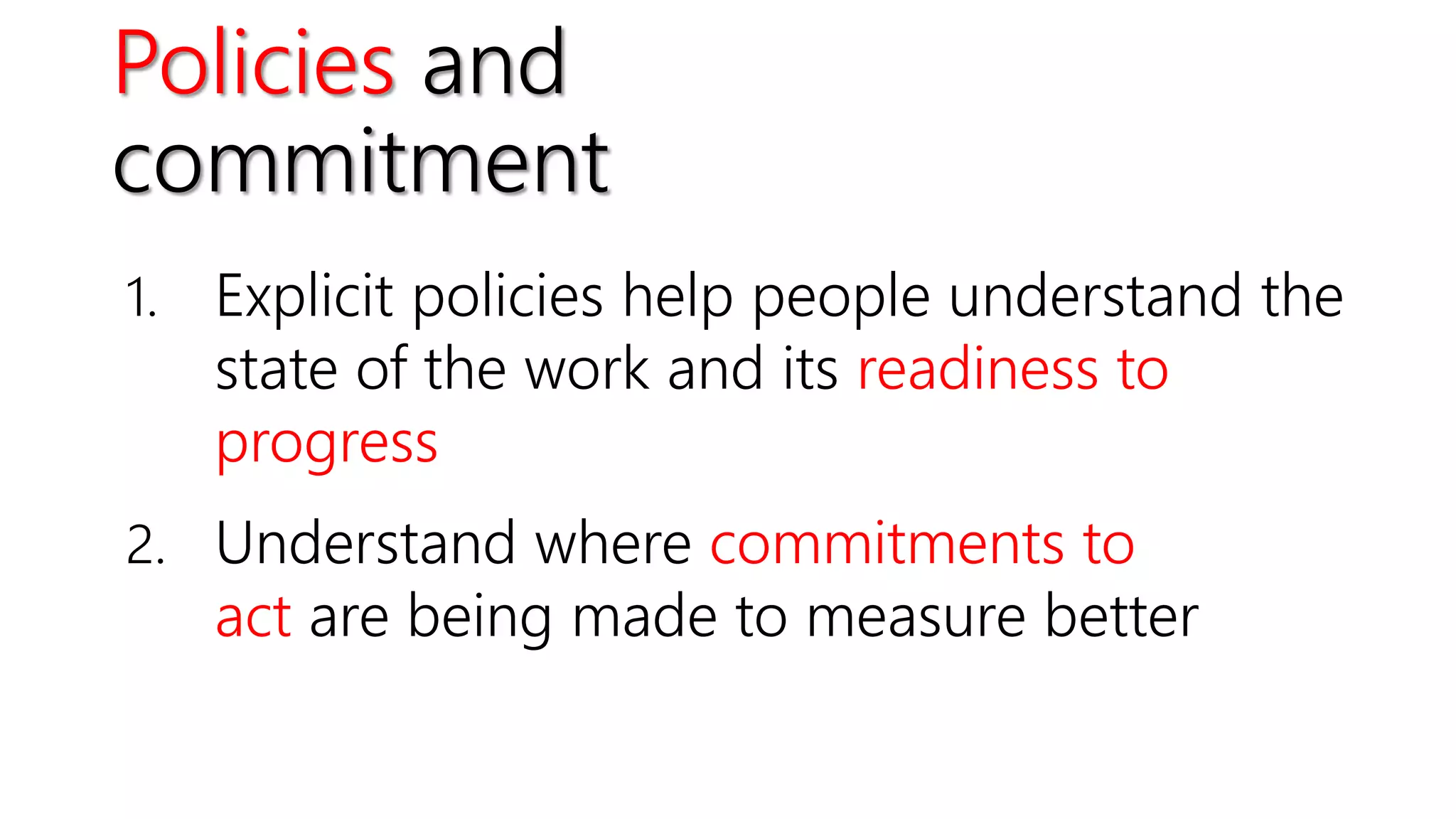

Policies and
commitment
1. Explicit policies help people understand the
state of the work and its readiness to
progress
2. Understand where commitments to
act are being made to measure better

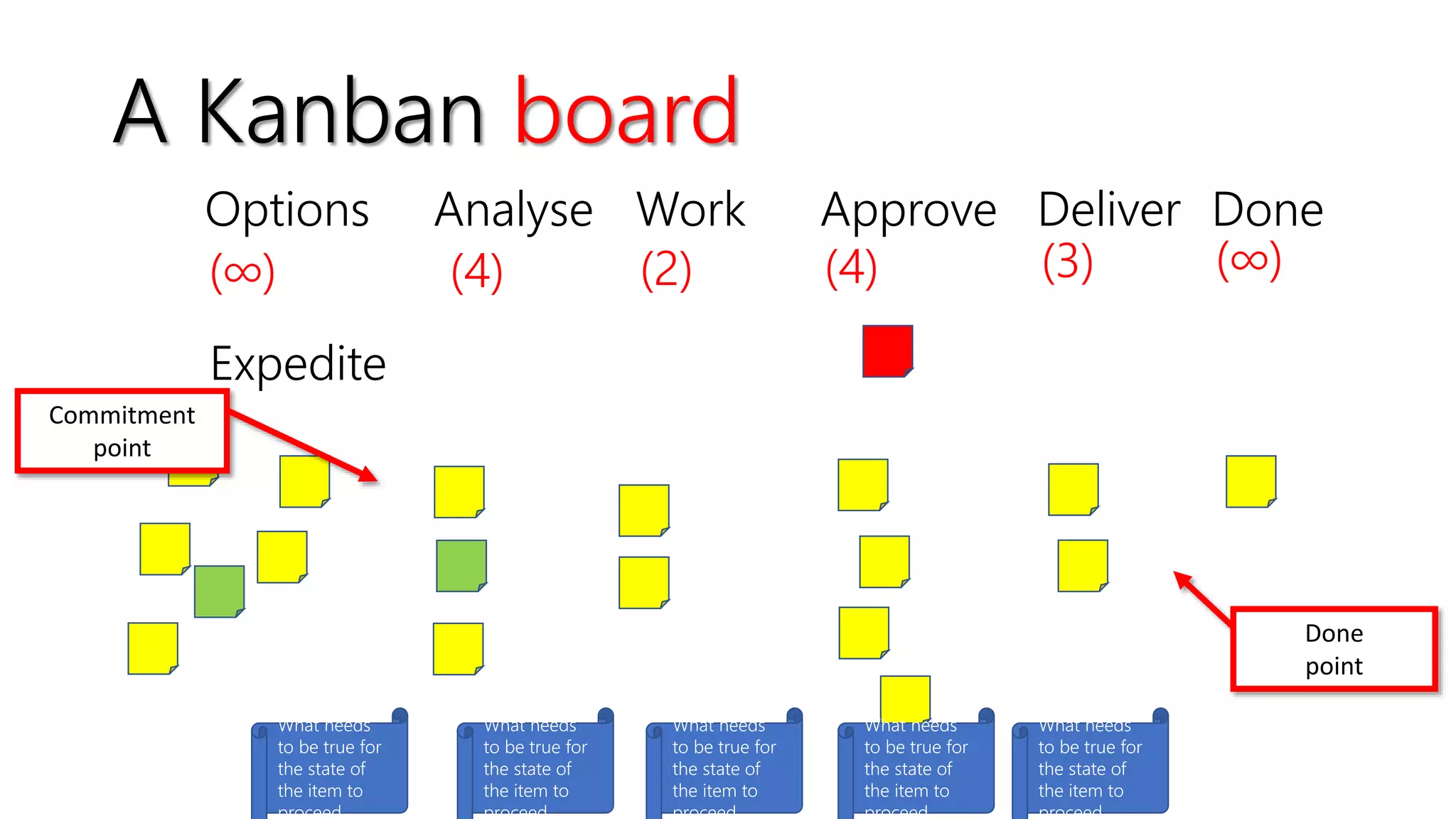

A Kanban board
(∞) (4) (2) (4) (3) (∞)
Expedite
Options Analyse Work Approve Deliver Done
Commitment
point
What needs
to be true for
the state of
the item to
proceed
What needs
to be true for
the state of
the item to
proceed
What needs
to be true for
the state of
the item to
proceed
What needs
to be true for
the state of
the item to
proceed
What needs
to be true for
the state of
the item to
proceed

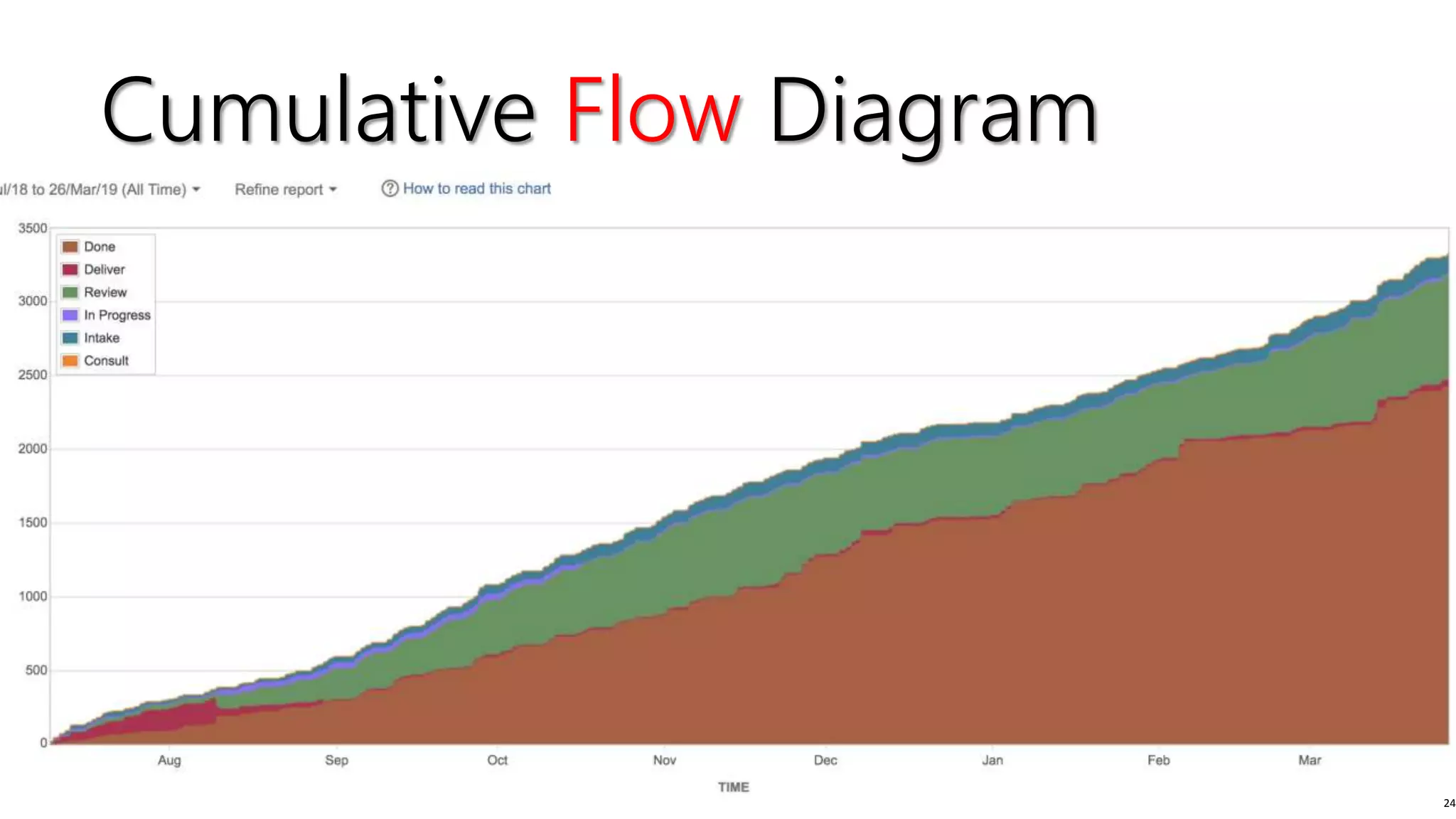

24

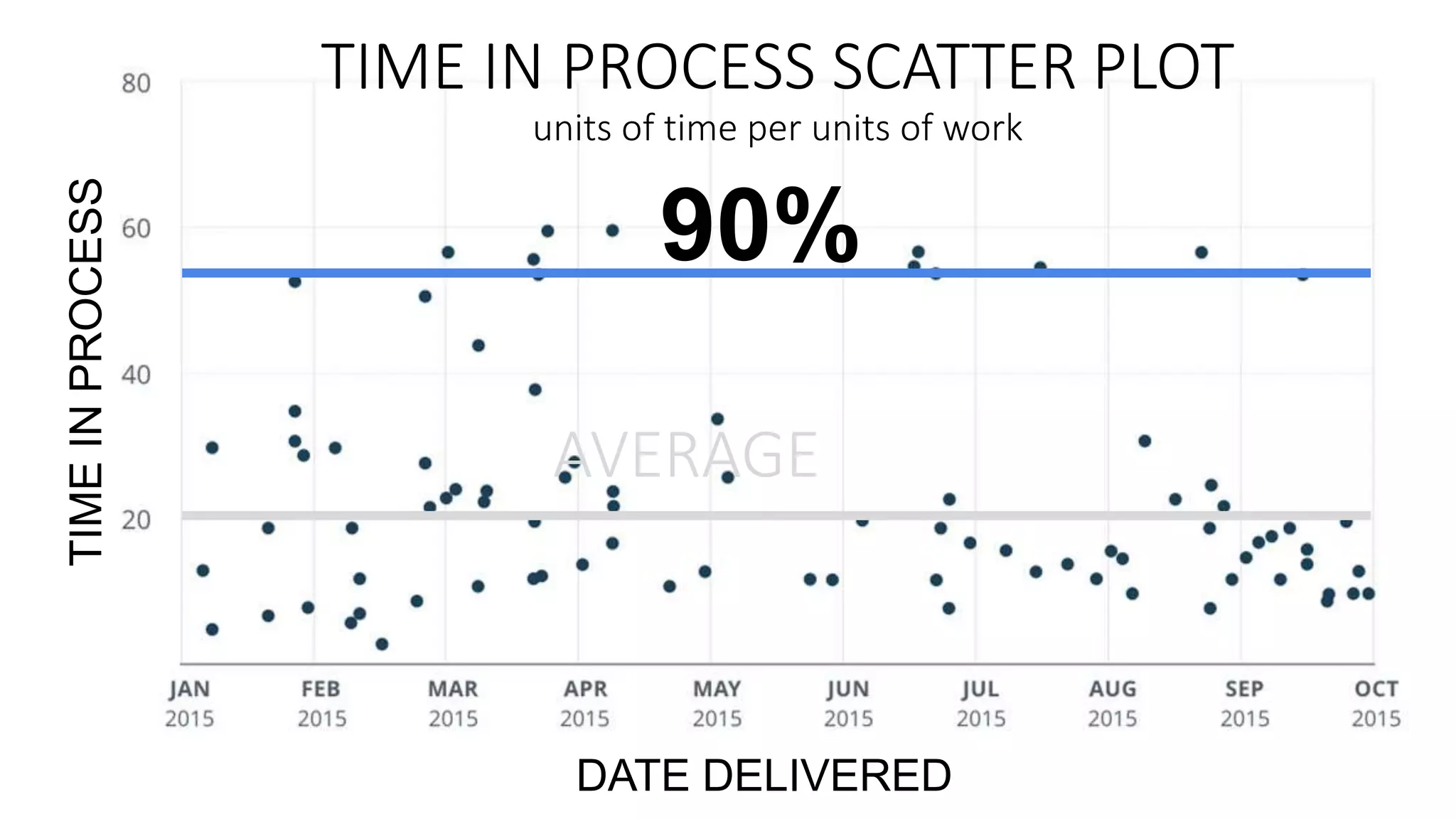

Cumulative Flow Diagram
TIMEINPROCESS
90%
AVERAGE

DATE DELIVERED

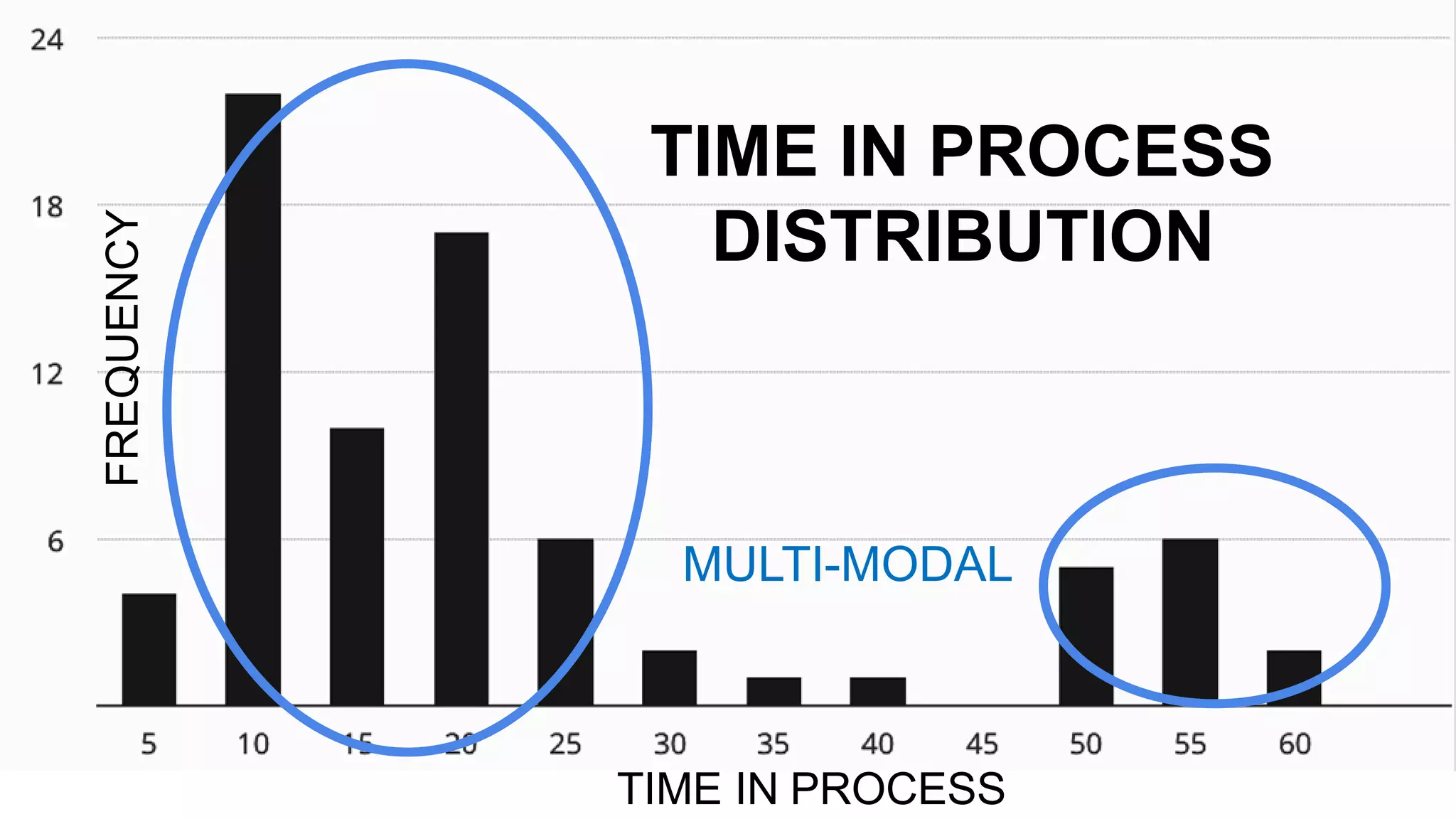

TIME IN PROCESS SCATTER PLOT
units of time per units of work
FREQUENCY
TIME IN PROCESS
TIME IN PROCESS
DISTRIBUTION
MULTI-MODAL
TIMEINPROCESS
90%
DATE DELIVERED
AVERAGE
TIMEINPROCESS

THROUGHPUT
Units of work per unit of time
DATE DELIVERED
TIMEINPROCESS
DATE DELIVERED

9 9 11
6
4
6
4
10
13
A Kanban board
(∞) (4) (2) (4) (3) (∞)
Expedite
Options Analyse Work Approve Deliver Done
Commitment
point
What needs
to be true for
the state of
the item to
proceed
What needs
to be true for
the state of
the item to
proceed
What needs
to be true for
the state of
the item to
proceed
What needs
to be true for
the state of
the item to
proceed
What needs
to be true for
the state of
the item to
proceed
Done
point
Methods to manage change

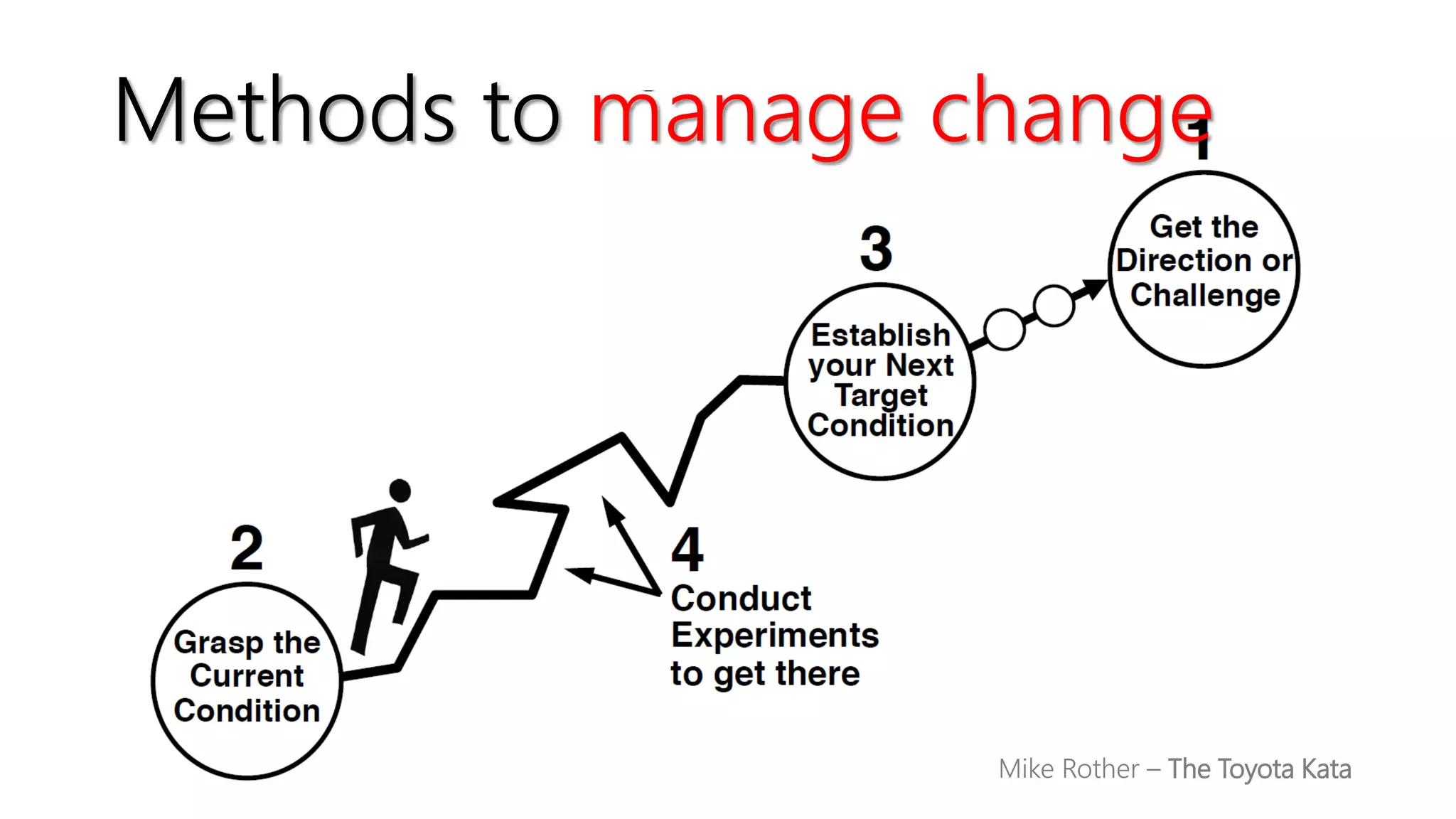

Mike Rother – The Toyota Kata
Methods to manage change

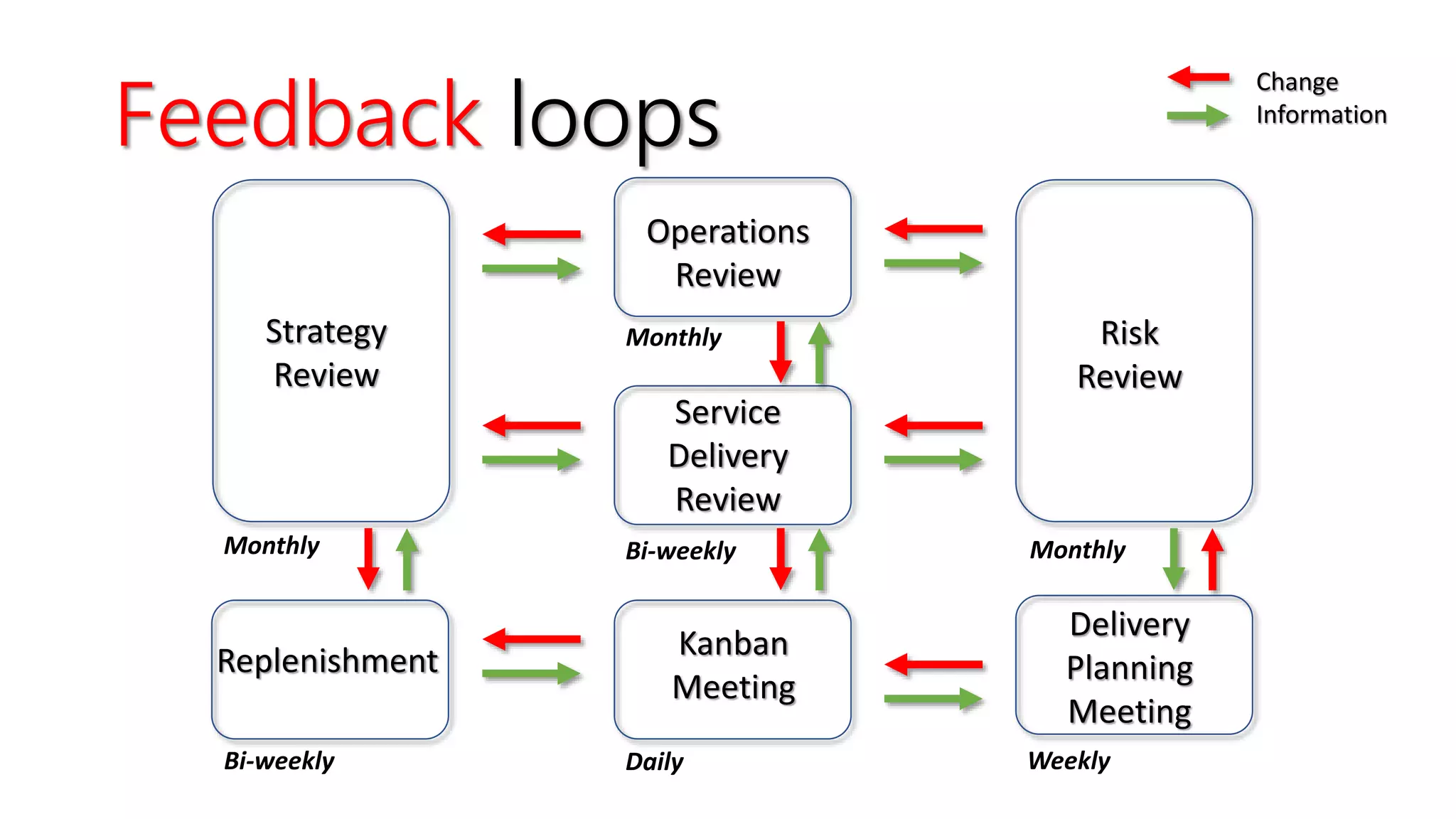

Change
Information
Replenishment
Bi-weekly
Kanban
Meeting
Daily
Delivery
Planning
Meeting
Weekly
Service
Delivery
Review
Bi-weekly
Risk
Review
Monthly
Operations
Review
MonthlyStrategy
Review
Monthly
https://medium.com/@justynapindel/the-seven-kanban-cadences-
Kanban cadences
Change
Information
Replenishment
Bi-weekly
Kanban
Meeting
Daily
Delivery
Planning
Meeting
Weekly
Service
Delivery
Review
Bi-weekly
Risk
Review
Monthly
Operations
Review
MonthlyStrategy
Review
Monthly
Feedback loops
Visualize
Manage flow
Experiment to evolve
Limit WIP

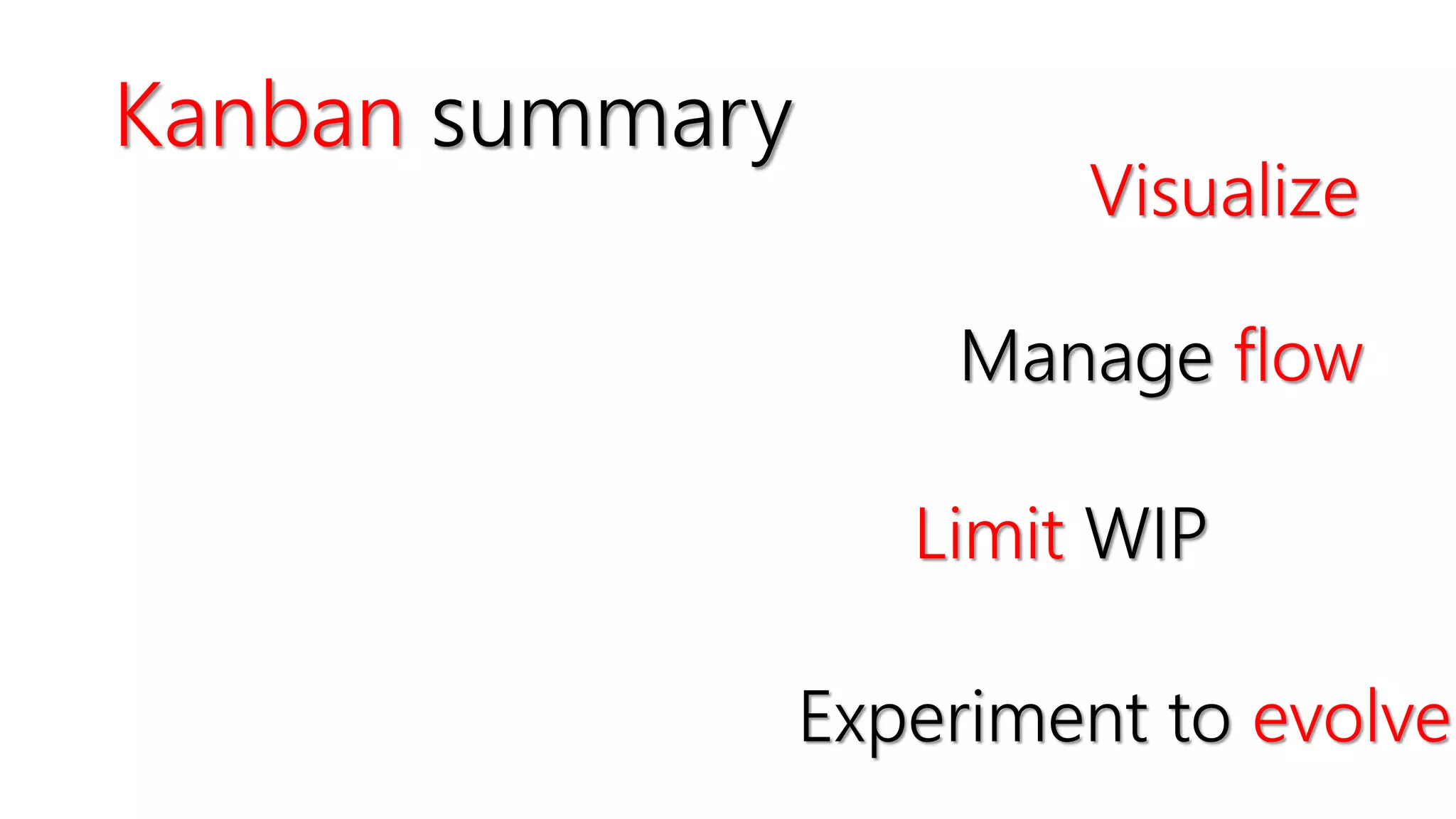

Kanban summary
A place to start
https://bit.ly/31nh3Qa

• Kanban from the Inside - Mike Burrows, 2014
• Personal Kanban - Jim Bensen & Tonianne DeMaria Barry,
2011
• Making Work Visible - Dominica DeGrandis, 2017
• Stop Starting, Start Finishing - Arne Rooke, 2013
• Kanban in Action - Marcus Hammarberg & Joakim Sunden,
2014
• Kanban: Successful Evolutionary Change for Your Technology
An incomplete list of great books

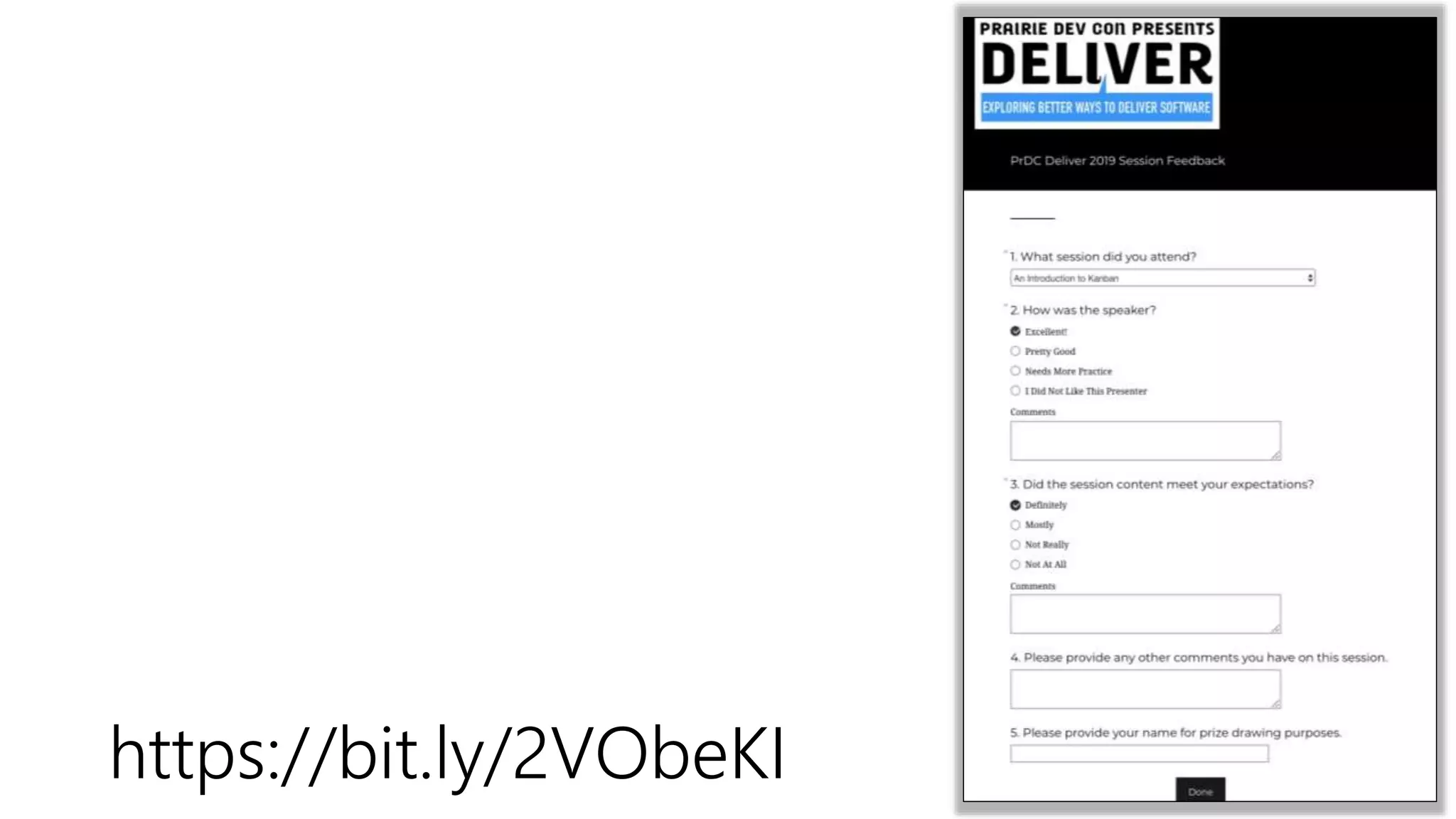

https://bit.ly/2VObeKI
