Presented to the Ottawa Public Library Board
                           November 18, 2011
            Presented by Denise Vaillancourt
                     City Librarian and CEO

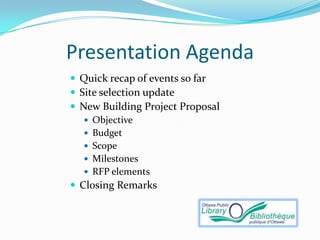

Presentation Agenda
 Quick recap of events so far
 Site selection update
 New Building Project Proposal
    Objective
    Budget
    Scope
    Milestones
    RFP elements
 Closing Remarks
The Project Vision

An Extraordinary Building – Uniting a
        Vibrant Community!
The Journey So Far
 City of Ottawa’s Long Range Plan in 2006 includes the
  new central library as an unfunded project
 In 2007 the OPL board approves the New Central
  Library Detailed Functional Program
 City approves $26M in 2009 for land acquisition for
  new library site
 In 2010, the city begins to acquire land on selected site
  and continues into 2011

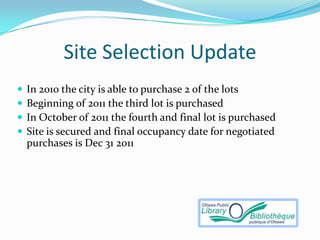

Site Selection Update
   In 2010 the city is able to purchase 2 of the lots
   Beginning of 2011 the third lot is purchased
   In October of 2011 the fourth and final lot is purchased
   Site is secured and final occupancy date for negotiated
    purchases is Dec 31 2011

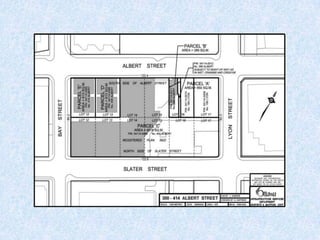

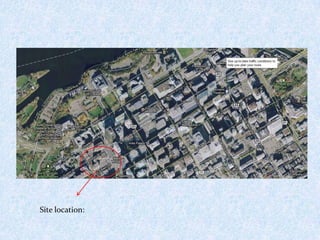

Site location:
Objective of the Project
 Build a new City of Ottawa Library that incorporates
 the key planning concepts and functional programs
 elaborated in the New Central Library Project.

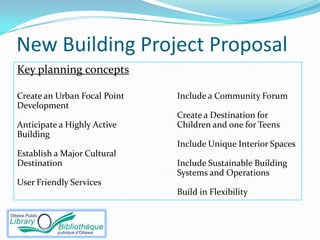

New Building Project Proposal
Key planning concepts

Create an Urban Focal Point   Include a Community Forum
Development
                              Create a Destination for
Anticipate a Highly Active    Children and one for Teens
Building
                              Include Unique Interior Spaces
Establish a Major Cultural
Destination                   Include Sustainable Building
                              Systems and Operations
User Friendly Services
                              Build in Flexibility
Highlights of Functional Program
        Spaces                 Functions             Learning Centres

• Concourse, Meeting     • Community Library      • Languages and
  Rooms, and Ancillary   • Technology,              Literacy
  Services                 Communications         • Business and Careers
• City of Ottawa           and Digital Services   • Local History and
  Heritage Gateway       • Administrative           Genealogy
• Welcome Centre           Services
• Children’s Services    • Materials Handling
• Teen Zone                and Operations
• Fiction, Newspapers
  and Magazines          • Leasable Space
Detailed Numbers
 Building Gross Area:    325,000 square feet
   Future Expansion:     22,500 square feet
   Number of Levels:     one sub-grade, ground floor
                          and four additional
   Parking Area On-Site: 300 underground spaces
   Exterior Space Area:  12,500 square feet
                          extensively developed

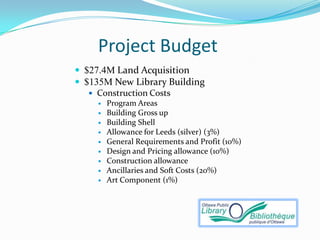

Project Budget
 $27.4M Land Acquisition
 $135M New Library Building
    Construction Costs
        Program Areas
        Building Gross up
        Building Shell
        Allowance for Leeds (silver) (3%)
        General Requirements and Profit (10%)
        Design and Pricing allowance (10%)
        Construction allowance
        Ancillaries and Soft Costs (20%)
        Art Component (1%)

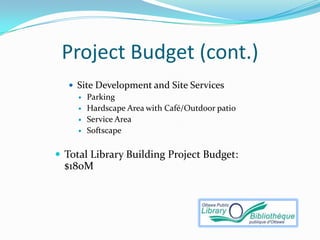

Project Budget (cont.)
    Site Development and Site Services
      Parking
      Hardscape Area with Café/Outdoor patio
      Service Area
      Softscape

 Total Library Building Project Budget:
  $180M

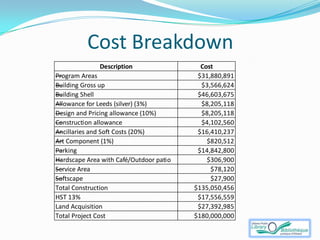

Cost Breakdown
              Description                  Cost
—
Program Areas                             $31,880,891
—
Building Gross up                          $3,566,624
—
Building Shell                            $46,603,675
—
Allowance for Leeds (silver) (3%)          $8,205,118
—
Design and Pricing allowance (10%)         $8,205,118
—
Construction allowance                     $4,102,560
—
Ancillaries and Soft Costs (20%)          $16,410,237
— Component (1%)
Art                                          $820,512
—
Parking                                   $14,842,800
—
Hardscape Area with Café/Outdoor patio       $306,900
—
Service Area                                  $78,120
—
Softscape                                     $27,900
Total Construction                       $135,050,456
HST 13%                                   $17,556,559
Land Acquisition                          $27,392,985
Total Project Cost                       $180,000,000

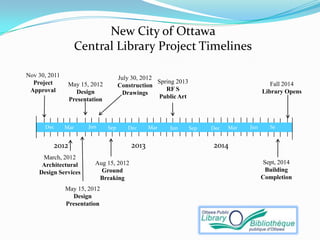

New City of Ottawa
                     Central Library Project Timelines

Nov 30, 2011                         July 30, 2012
  Project       May 15, 2012                       Spring 2013                              Fall 2014
                                     Construction
 Approval         Design                              RF S                               Library Opens
                                       Drawings
                Presentation                       Public Art

      Dec      Mar     Jun     Sep      Dec     Mar    Jun       Sep   Dec   Mar   Jun     Se
                                                                                           p

         2012                            2013                          2014
     March, 2012
     Architectural       Aug 15, 2012                                                    Sept, 2014
    Design Services        Ground                                                         Building
                          Breaking                                                       Completion
               May 15, 2012
                 Design
               Presentation

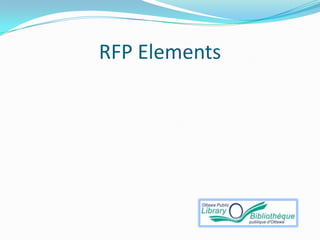

RFP Elements

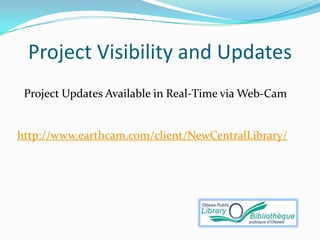

Project Visibility and Updates
 Project Updates Available in Real-Time via Web-Cam

http://www.earthcam.com/client/NewCentralLibrary/
Salt Lake City Public Library
Vancouver Public Library
ISI 6100 Presentation
ISI 6100 Presentation
ISI 6100 Presentation
ISI 6100 Presentation
ISI 6100 Presentation

ISI 6100 Presentation
